PUBLIC
Christoph Ernst, SAP
July, 2017
SAP Financial Closing cockpit in SAP S/4HANA
Status and Roadmap

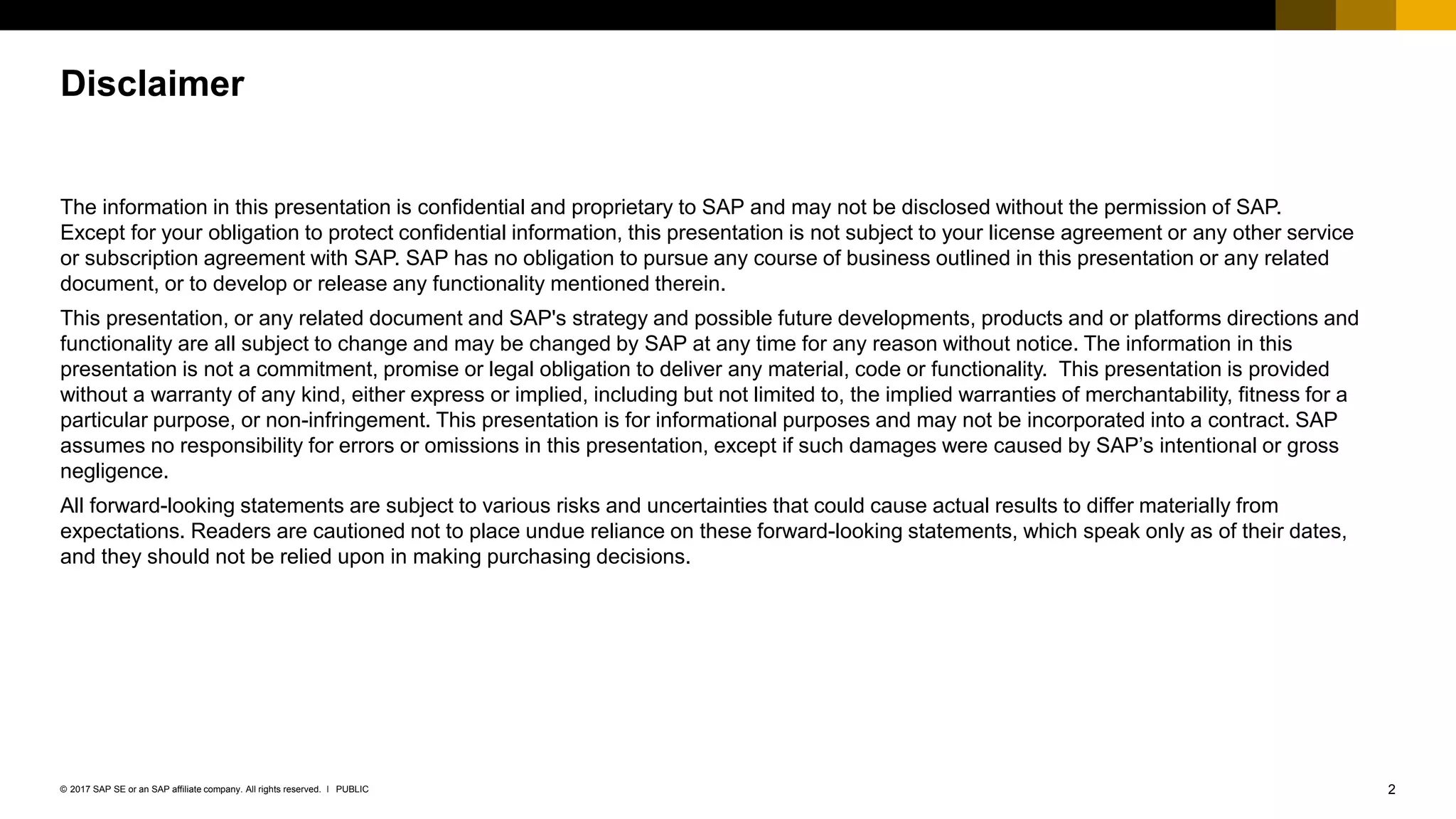

2PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
The information in this presentation is confidential and proprietary to SAP and may not be disclosed without the permission of SAP.
Except for your obligation to protect confidential information, this presentation is not subject to your license agreement or any other service
or subscription agreement with SAP. SAP has no obligation to pursue any course of business outlined in this presentation or any related
document, or to develop or release any functionality mentioned therein.
This presentation, or any related document and SAP's strategy and possible future developments, products and or platforms directions and
functionality are all subject to change and may be changed by SAP at any time for any reason without notice. The information in this
presentation is not a commitment, promise or legal obligation to deliver any material, code or functionality. This presentation is provided
without a warranty of any kind, either express or implied, including but not limited to, the implied warranties of merchantability, fitness for a
particular purpose, or non-infringement. This presentation is for informational purposes and may not be incorporated into a contract. SAP
assumes no responsibility for errors or omissions in this presentation, except if such damages were caused by SAP’s intentional or gross
negligence.
All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from
expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, which speak only as of their dates,
and they should not be relied upon in making purchasing decisions.
Disclaimer
3PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
4PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
5PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

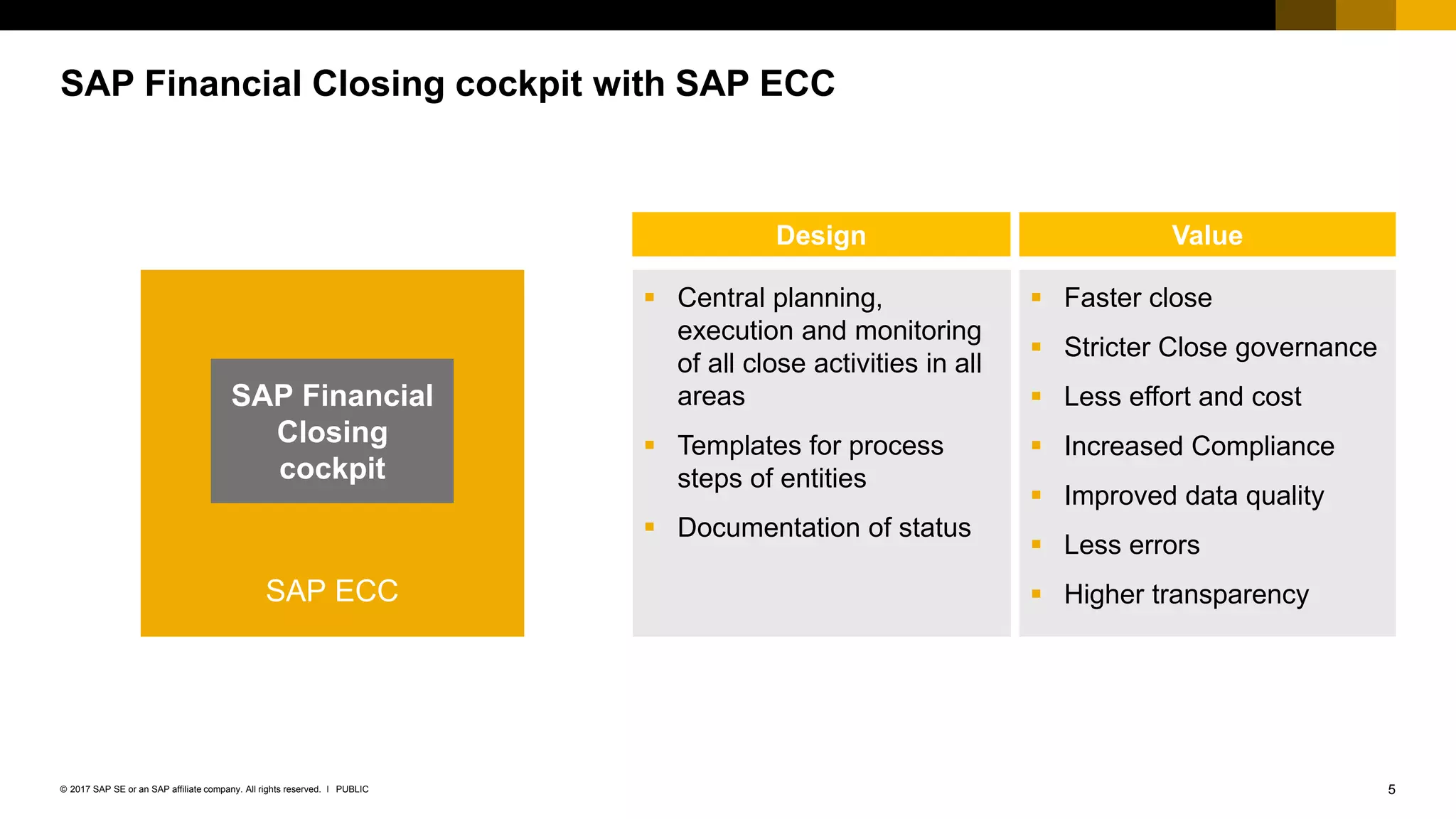

SAP Financial Closing cockpit with SAP ECC
SAP ECC
SAP Financial
Closing
cockpit
 Faster close
 Stricter Close governance
 Less effort and cost
 Increased Compliance
 Improved data quality
 Less errors
 Higher transparency
 Central planning,
execution and monitoring
of all close activities in all
areas
 Templates for process
steps of entities
 Documentation of status
Design Value
6PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

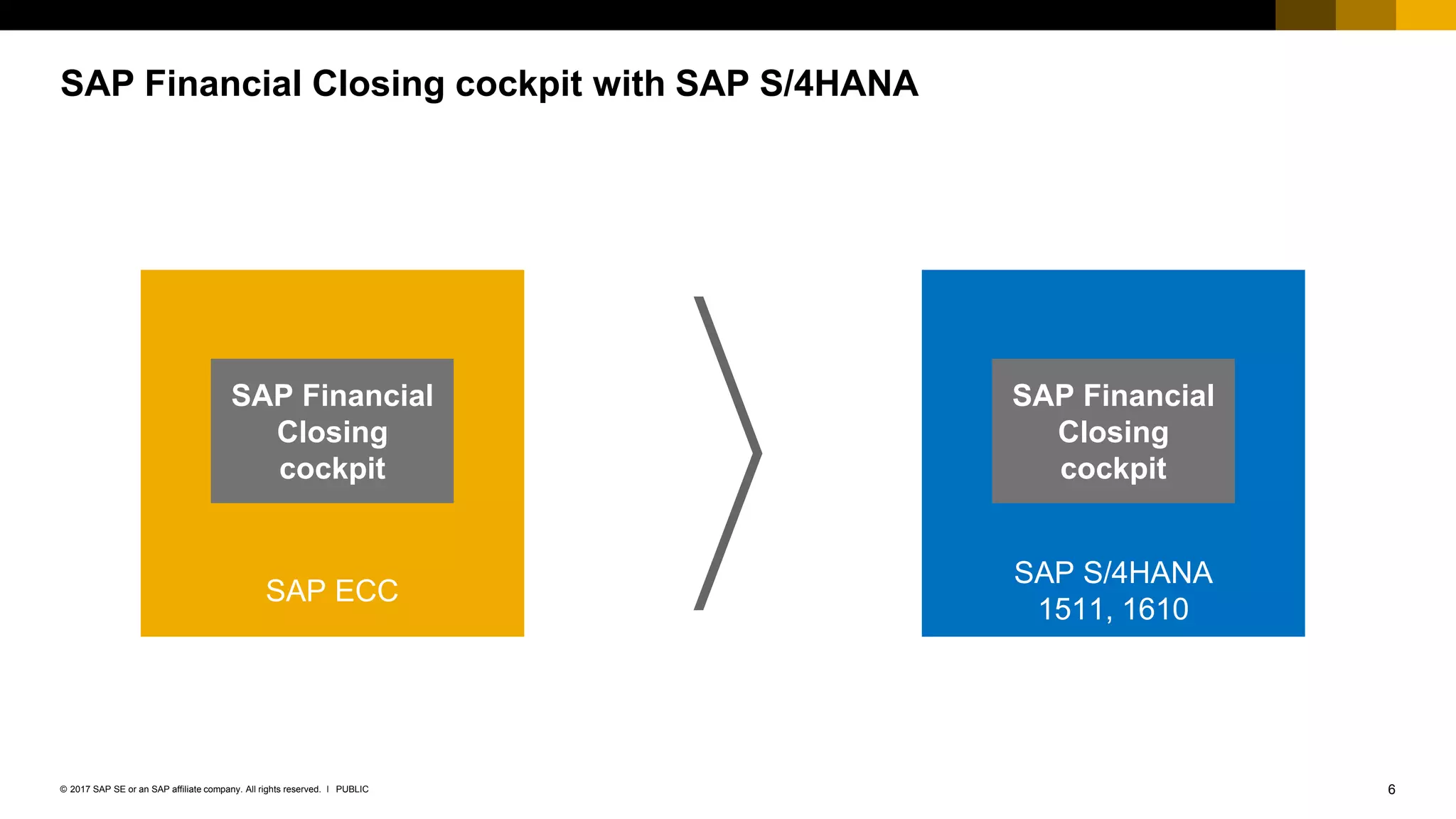

SAP Financial Closing cockpit with SAP S/4HANA
SAP ECC
SAP S/4HANA
1511, 1610
SAP Financial
Closing
cockpit
SAP Financial
Closing
cockpit
7PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

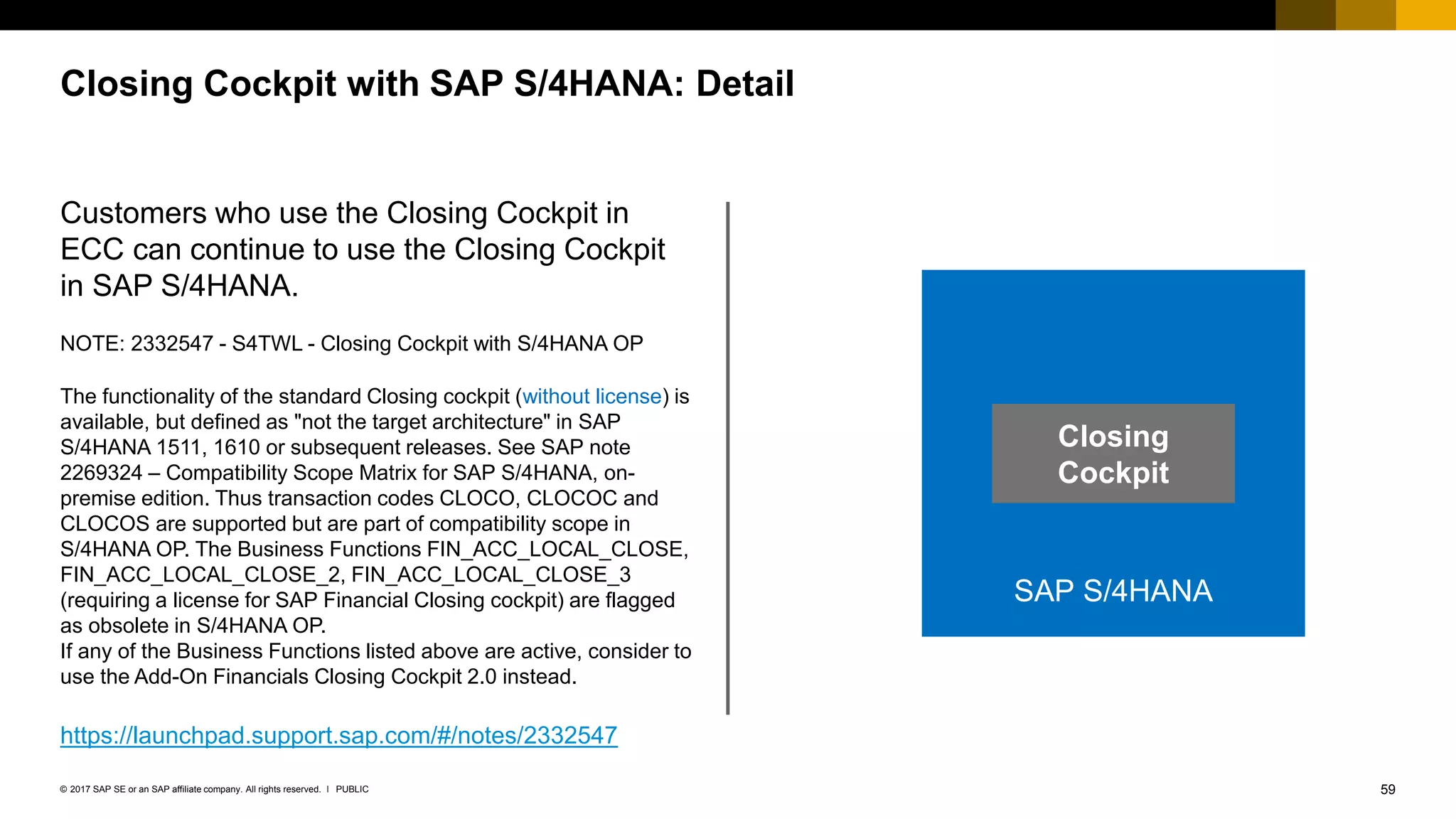

 Customers who use the SAP Financial Closing
cockpit in ECC can continue to use the SAP
Financial Closing Cockpit in SAP S/4HANA.
 Customers can start using SAP Financial Closing
cockpit with SAP S/4HANA 1511 or 1610 as well.
 SAP Financial Closing cockpit = Transactions
codes „FCLOCOx“
 However, SAP Financial Closing cockpit remains
part of the compatibility scope matrix (since the
list should remain stable; note: 2269324)
SAP Financial Closing cockpit with SAP S/4HANA: Detail
SAP S/4HANA
1511, 1610
SAP Financial
Closing
cockpit
8PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

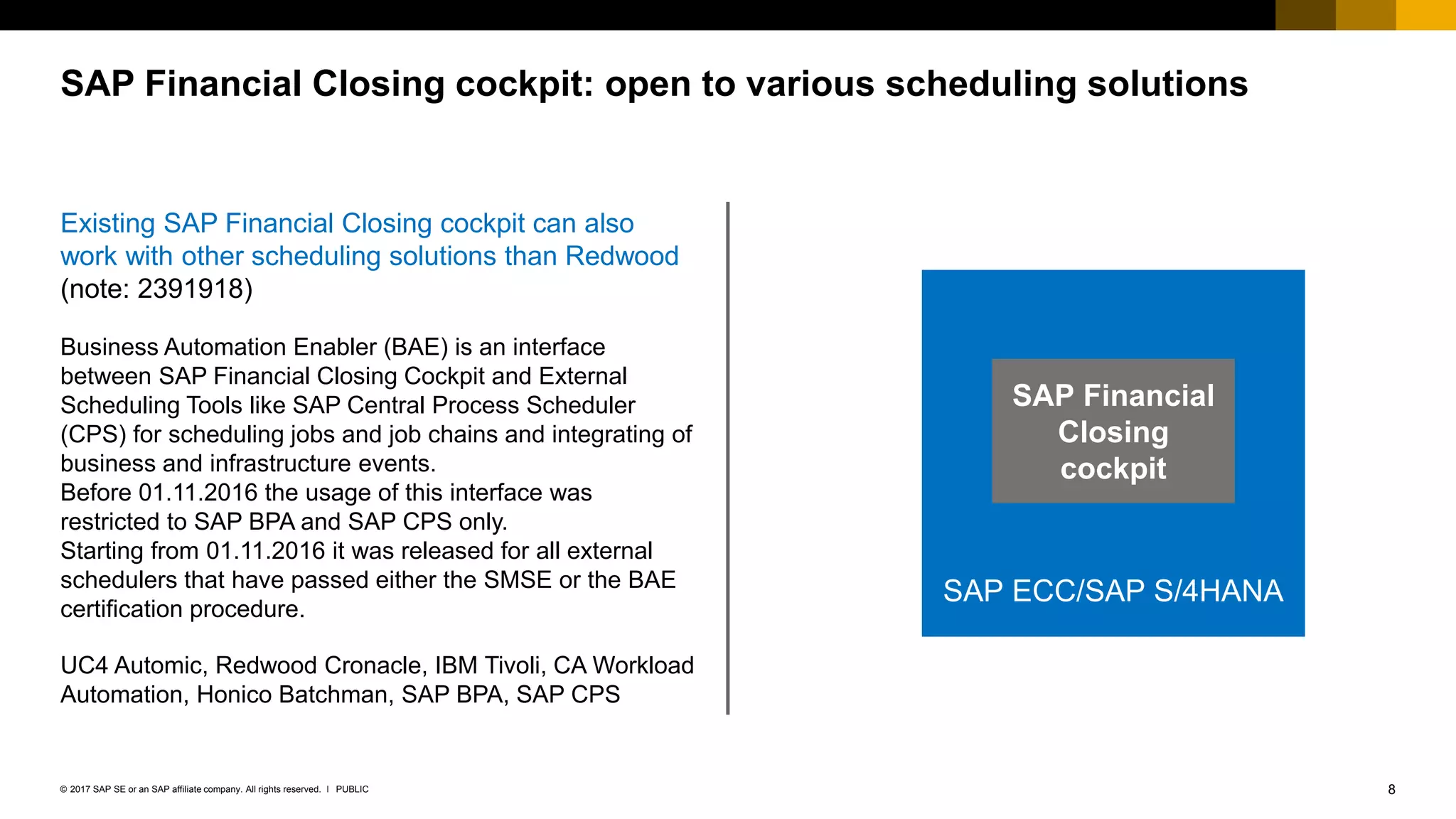

Existing SAP Financial Closing cockpit can also
work with other scheduling solutions than Redwood
(note: 2391918)
Business Automation Enabler (BAE) is an interface
between SAP Financial Closing Cockpit and External
Scheduling Tools like SAP Central Process Scheduler
(CPS) for scheduling jobs and job chains and integrating of
business and infrastructure events.
Before 01.11.2016 the usage of this interface was
restricted to SAP BPA and SAP CPS only.
Starting from 01.11.2016 it was released for all external
schedulers that have passed either the SMSE or the BAE
certification procedure.
UC4 Automic, Redwood Cronacle, IBM Tivoli, CA Workload
Automation, Honico Batchman, SAP BPA, SAP CPS
SAP Financial Closing cockpit: open to various scheduling solutions
SAP ECC/SAP S/4HANA
SAP Financial
Closing
cockpit
9PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
10PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Perfect Planning, Automation and Monitoring –
SAP S/4HANA Financial Closing cockpit
Benefits
Faster Entity Close through
improved closing efficiency
Governance and Compliance
Transparency and Insight
15-25% Faster Closing cycle – while ensuring high quality compliant results
Source: SAP Performance Benchmarking
Capabilities
Automated closing tasks, even in remote
systems and powerful, user-friendly
application for manual tasks
Collaboration, notifications, and workflows
Define a global game plan for the entity
close; leverage it for multiple org units and
closing cycles
Audit trail, logging, documentation
Real-time insight into the closing status
Monitoring by subsidiaries and headquarter
Close Analysis
* This is the current state of planning and may be changed by SAP at any time without notice.
11PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Planned innovations: SAP S/4HANA 1709
Focus: provide SAP S/4HANA on premise customers with SAP FCc
 part of SAP S/4HANA Core (no add-on anymore) with comparable functionality as add-on
 Fioritized UX (on the basis of existing transactions)
Product vision: Intelligent Financial Closing cockpit on SAP Cloud Platform
Focus: cloud, automation, machine learning and analytics
 Cloud: Flexible deployment option, connectivity to on premise and cloud
 Automation: Scheduling or processing of closing tasks in due sequence with complete audit trail for status changes, incidents and relevant
result objects; approval workflow for specific tasks
 Machine Learning: leverage existing and planned
Apps like GR/IR, Intercompany, Accruals, Matching,
Reconciliation
 Analytics: Financial Close KPI Overview
SAP S/4HANA Financial Closing cockpit – Roadmap*
* This is the current state of planning and may be changed by SAP at any time without notice.
Mus
ter
Mus
ter
Mus
ter
Mus
ter

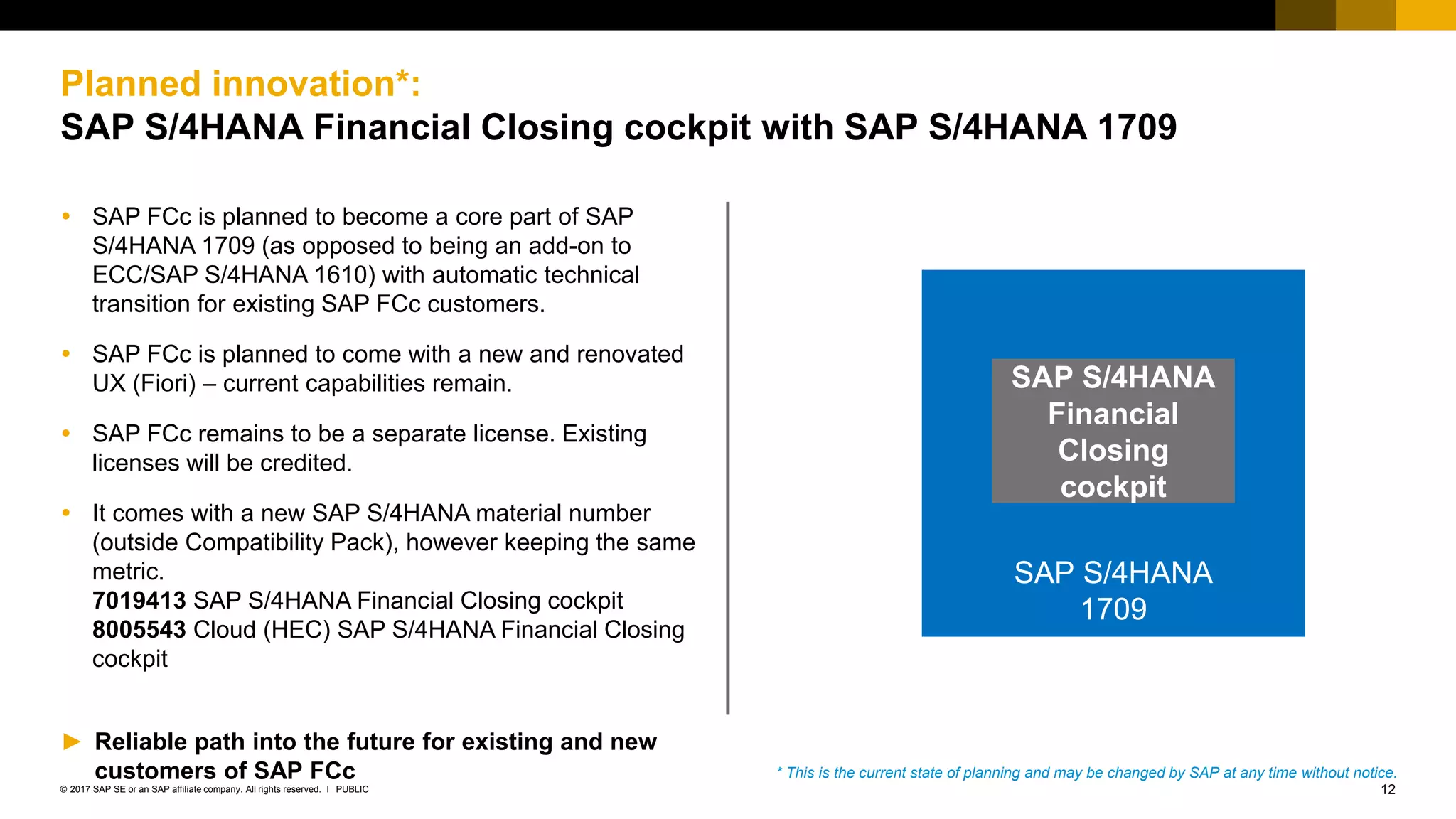

12PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
 SAP FCc is planned to become a core part of SAP
S/4HANA 1709 (as opposed to being an add-on to
ECC/SAP S/4HANA 1610) with automatic technical
transition for existing SAP FCc customers.
 SAP FCc is planned to come with a new and renovated
UX (Fiori) – current capabilities remain.
 SAP FCc remains to be a separate license. Existing
licenses will be credited.
 It comes with a new SAP S/4HANA material number
(outside Compatibility Pack), however keeping the same
metric.
7019413 SAP S/4HANA Financial Closing cockpit
8005543 Cloud (HEC) SAP S/4HANA Financial Closing
cockpit
► Reliable path into the future for existing and new
customers of SAP FCc
Planned innovation*:
SAP S/4HANA Financial Closing cockpit with SAP S/4HANA 1709
SAP S/4HANA
1709
SAP S/4HANA
Financial
Closing
cockpit
* This is the current state of planning and may be changed by SAP at any time without notice.
13PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

Planned innovation*:
SAP S/4HANA Financial Closing cockpit with SAP S/4HANA 1709
Muster
Muster
Muster
Muster
* This is the current state of planning and may be changed by SAP at any time without notice.
14PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Intelligent
Financial
Closing cockpit
SAP Cloud Platform
SAP S/4HANA

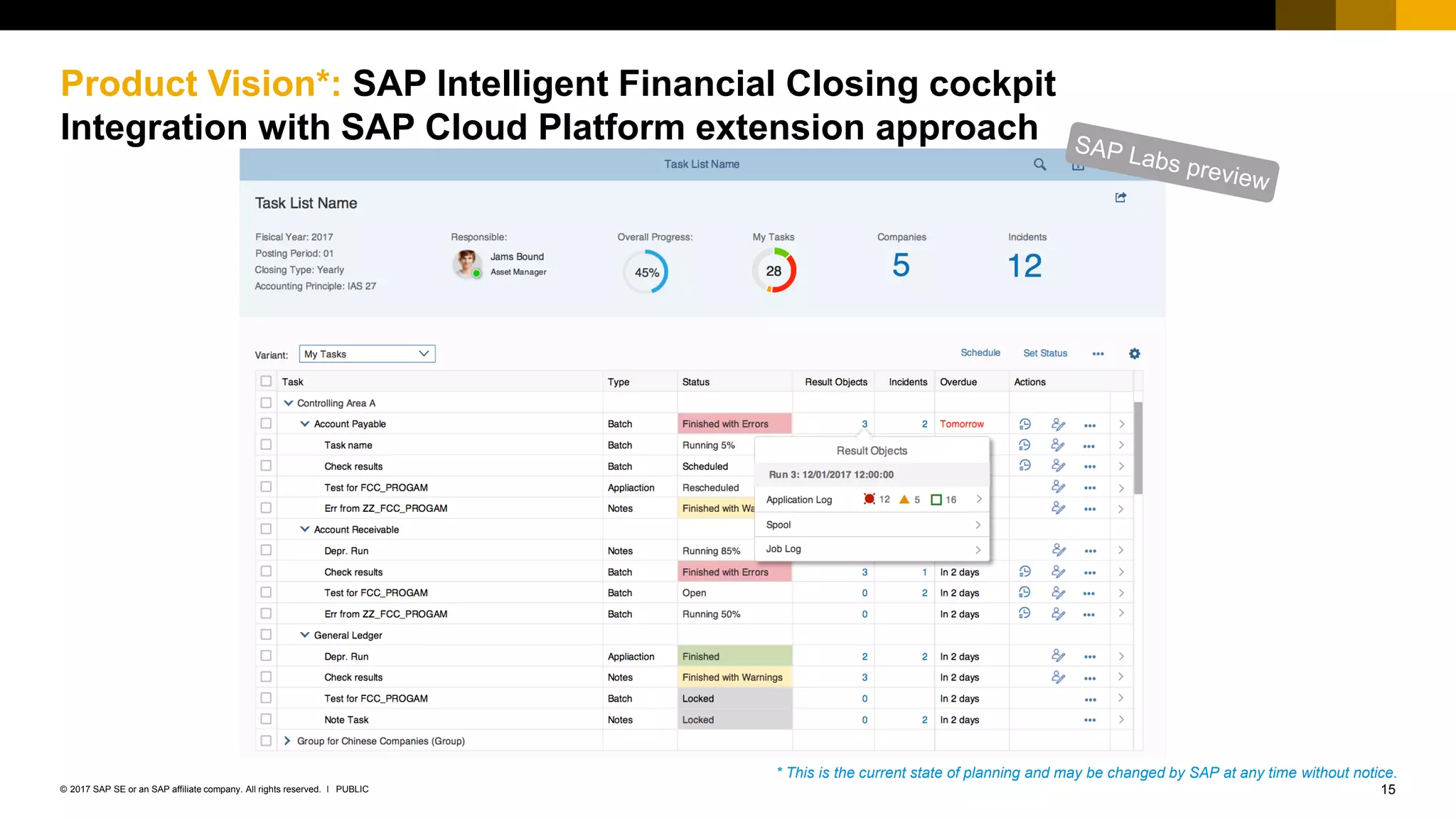

Product Vision*: SAP Intelligent Financial Closing cockpit
Integration with SAP Cloud Platform extension approach
Focus: cloud, automation, machine learning and analytics
 Cloud: Flexible deployment option, connectivity to on premise and cloud
 Automation: Scheduling or processing of closing tasks in due sequence with complete audit trail for status changes, incidents and
relevant result objects; approval workflow for specific tasks
 Machine Learning: leverage existing and planned Apps like GR/IR, Intercompany, Accruals, Matching, Reconciliation
 Analytics: Financial Close KPI Overview
SAP ERP SAP S/4HANA
Cloud
* This is the current state of planning and may be changed by SAP at any time without notice.
15PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

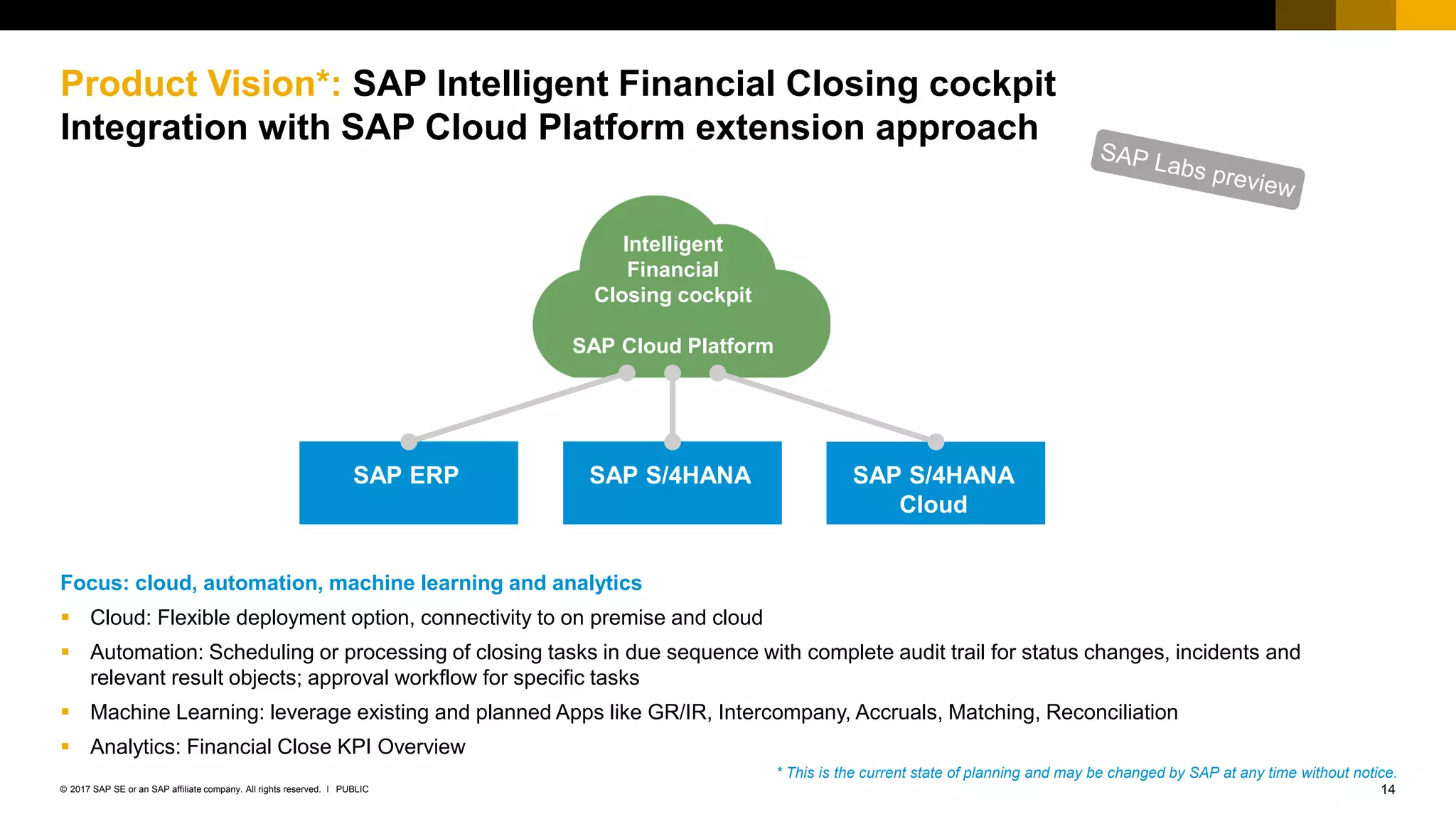

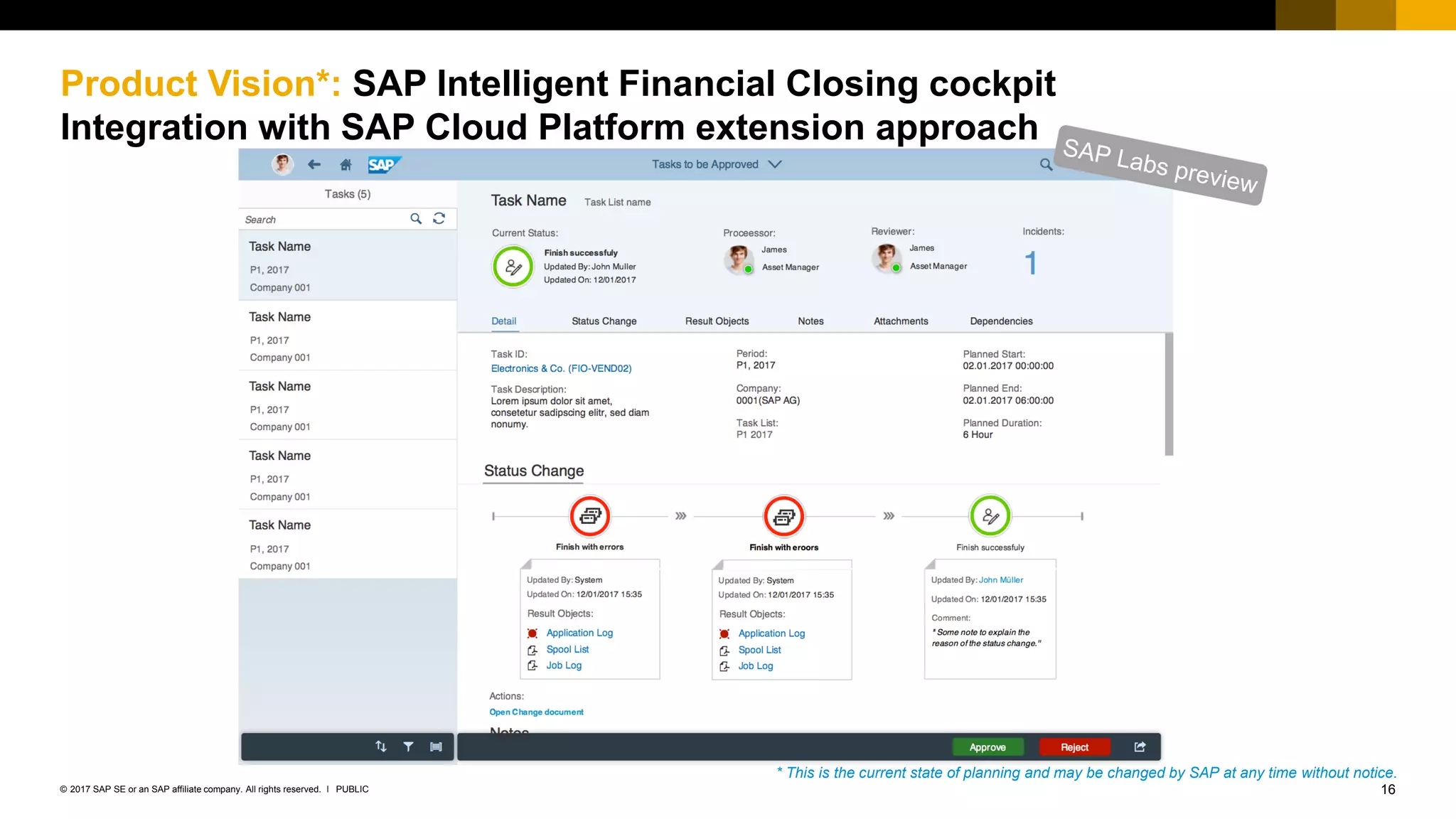

Product Vision*: SAP Intelligent Financial Closing cockpit
Integration with SAP Cloud Platform extension approach
* This is the current state of planning and may be changed by SAP at any time without notice.
16PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Product Vision*: SAP Intelligent Financial Closing cockpit
Integration with SAP Cloud Platform extension approach
* This is the current state of planning and may be changed by SAP at any time without notice.
17PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Product Vision*: SAP Intelligent Financial Closing cockpit
Integration with SAP Cloud Platform extension approach
* This is the current state of planning and may be changed by SAP at any time without notice.
18PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
19PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Financial
Closing cockpit
SAP S/4HANA

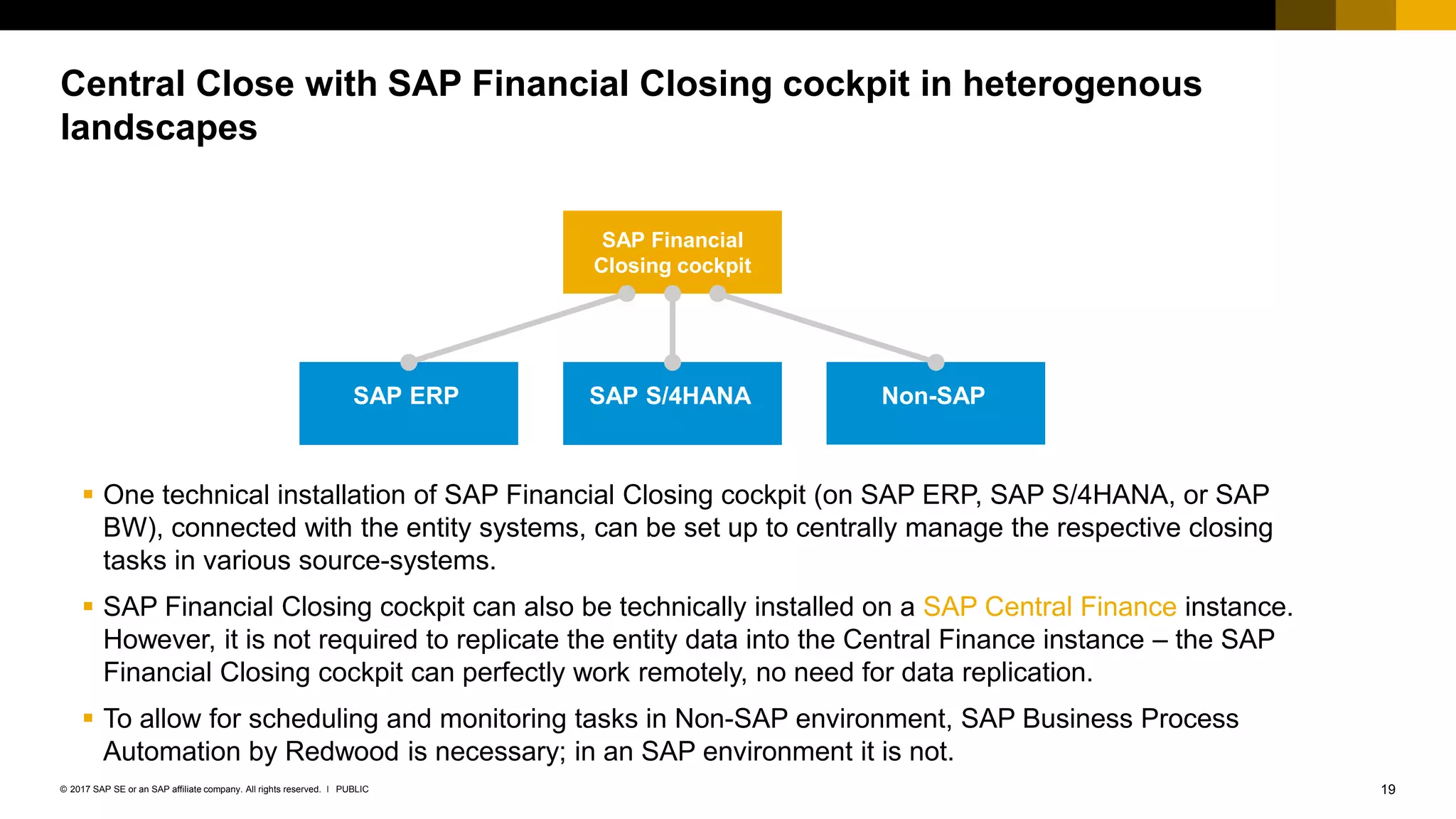

Central Close with SAP Financial Closing cockpit in heterogenous
landscapes
 One technical installation of SAP Financial Closing cockpit (on SAP ERP, SAP S/4HANA, or SAP
BW), connected with the entity systems, can be set up to centrally manage the respective closing
tasks in various source-systems.
 SAP Financial Closing cockpit can also be technically installed on a SAP Central Finance instance.
However, it is not required to replicate the entity data into the Central Finance instance – the SAP
Financial Closing cockpit can perfectly work remotely, no need for data replication.
 To allow for scheduling and monitoring tasks in Non-SAP environment, SAP Business Process
Automation by Redwood is necessary; in an SAP environment it is not.
SAP ERP Non-SAP
20PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Shared Service Framework
Introducing a new world of Digital Finance

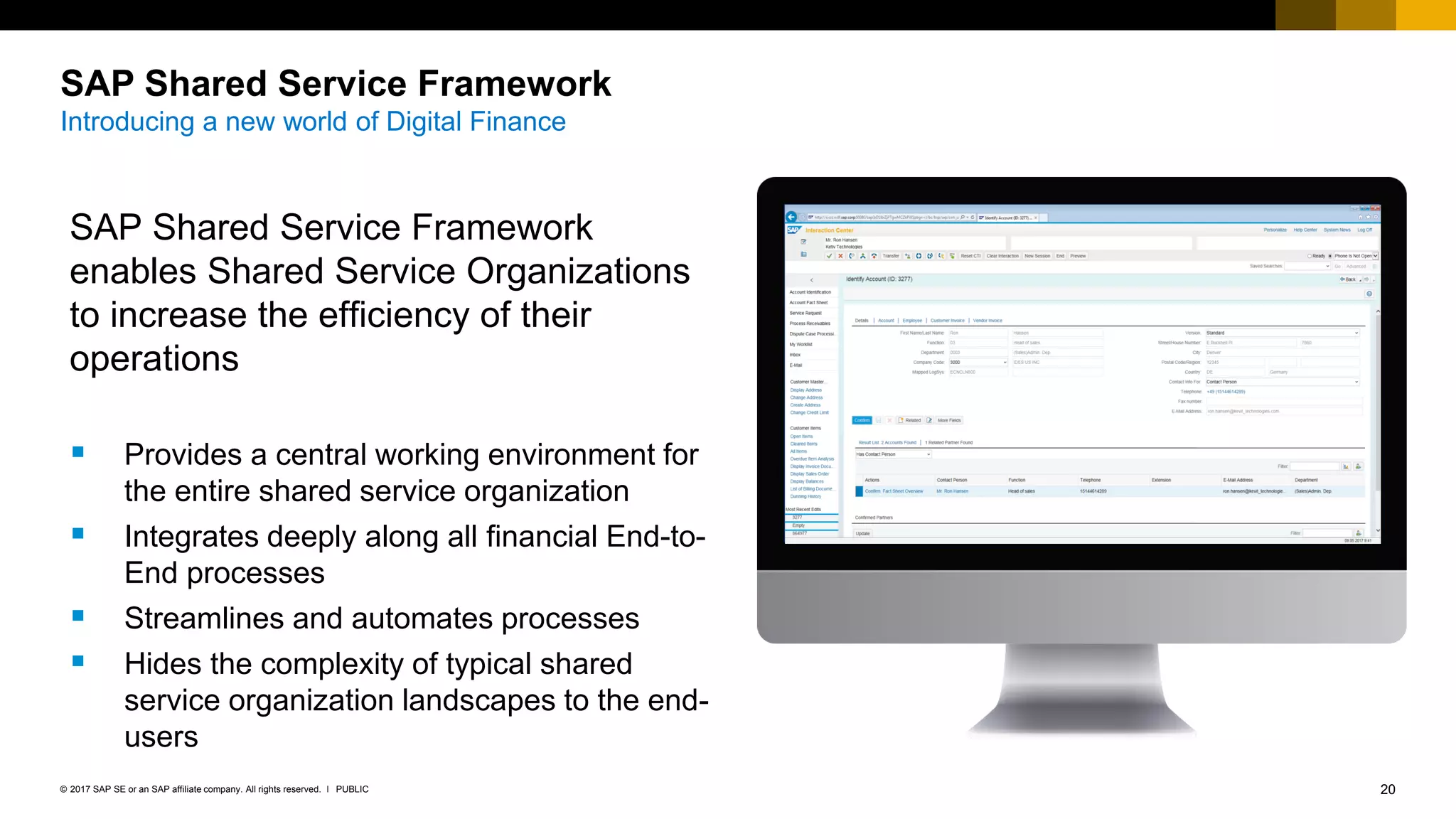

SAP Shared Service Framework
enables Shared Service Organizations
to increase the efficiency of their
operations
 Provides a central working environment for
the entire shared service organization
 Integrates deeply along all financial End-to-
End processes
 Streamlines and automates processes
 Hides the complexity of typical shared
service organization landscapes to the end-
users
21PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP‘s Service Management Platform
Providing state-of-the-art Service Management Capabilities
 Supporting a broad set of communication
channels
 Sophisticated Case Management
functionalities
 Complete transparency on Service Level
Agreements
 Clear responsibilities for efficient service
execution and delivery
 Increased transparency with embedded
Service Analytics
SAP
Shared Service
Framework
Service center
management
Communication
management
Service delivery
Service routing
Analytics
Governance and
compliance
22PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Planning the Implementation of SAP Enablers

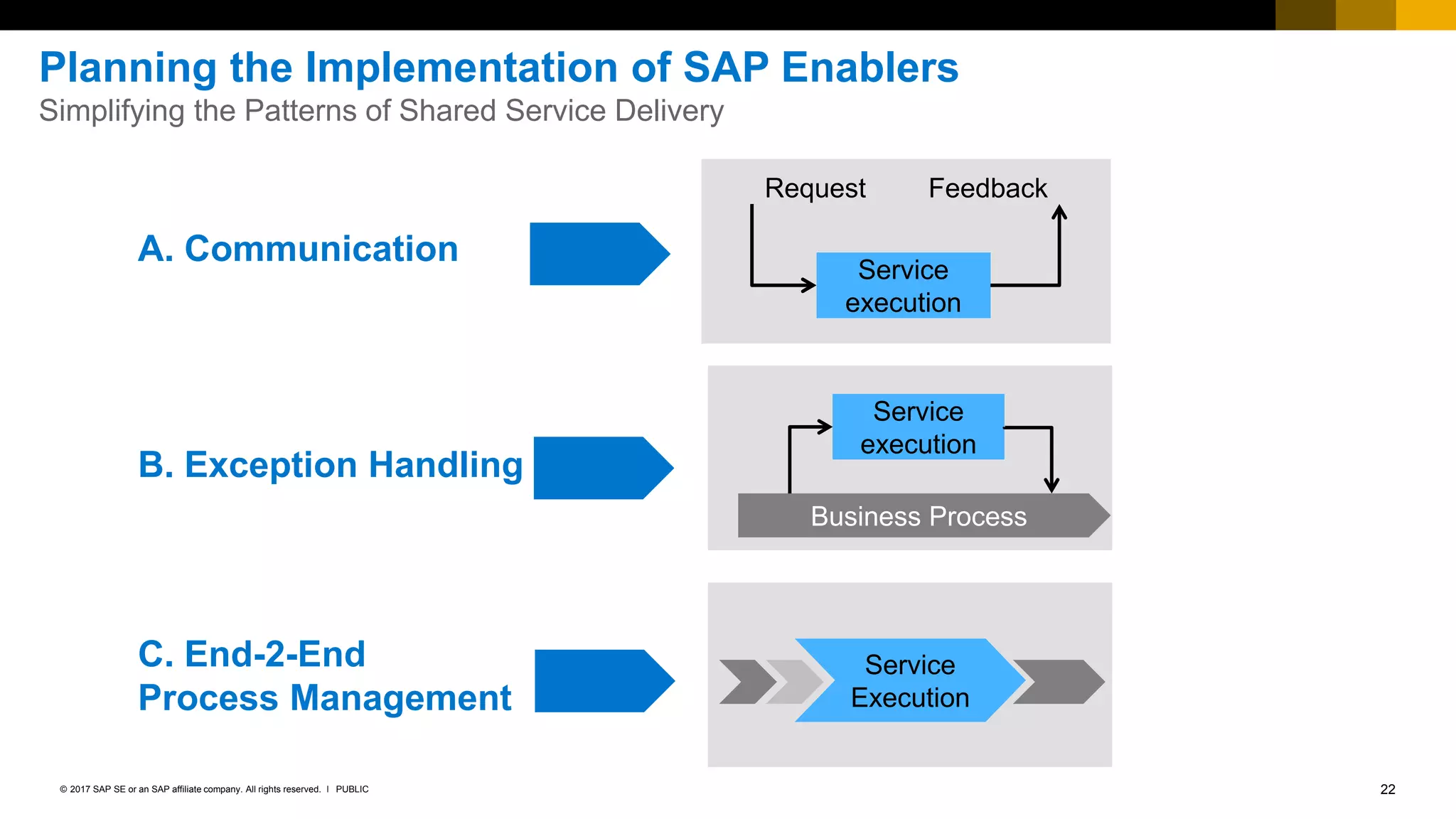

Simplifying the Patterns of Shared Service Delivery
Service
execution
Request Feedback
A. Communication
Service
execution
B. Exception Handling
Business Process
C. End-2-End
Process Management
Service
Execution
23PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Shared
Service
Framework
SAP Shared Service Framework
Deeply integrated out-of-the-box into SAP’s Finance Solution Portfolio
Integrated out-of-the-box with SAP end-to-
end automation engines
For example:
 Optimized Accounts Receivable Process with
Integrated collection and dispute worklists with SSF
and the SAP Receivables Management solutions
 Simplified communication and automated execution of
the Closing Process with SSF and SAP Financial
Closing Cockpit
 Enhanced issue resolution capabilities in Accounts
Payable with SSF and SAP Invoice Management by
Open Text
..and many more…
Accounts
Receivable
Closing
Process
And many
more
Accounts
Payables
24PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Support decisions and promote
accountability with insightful
analytics and sign-off
Perform automated,
exception-based
monitoring of ERP systems
Evaluate control design and effectiveness;
raise and remediate issues
Perform periodic risk
assessments to determine
scope and test strategies
Document controls and policies
centrally; map to key regulations
and impacted organizations
SAP Process Control
Ensure effective controls and on-going compliance
25PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP
Process
Control
SAP Process Control and SAP Financial Closing* cockpit
SAP S/4HANA
1709
SAP S/4HANA
Financial
Closing
cockpit
 It may be usefull to include
results of internal control
monitoring with SAP Process
Control into status overview
in SAP FCc (on project basis)
 Documentation and archiving
of results can be performed
in SAP FCc as well.
* Use cases described are valid with SAP FCc 2.0 as well.
26PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP FCc is not only about Closing:
Whenever system related tasks have to be carried out, steps
or results have to be docmented and/or collaborative work
needs to be supported, SAP FCc capabilities are ready to
support.
 Customers use SAP FCc for example to plan, monitor and
execute daily routines like payment and dunning runs.
 Often general, regular reporting tasks are incorporated
into the task lists to be controlled by SAP FCc.
 Sometimes SAP FCc is leveraged to collect and
document certain control activities as well.
► SAP FCc is designed to support Closing – however it
can also leverage far more tasks in the Finance
Department (and is not even limited to it).
SAP S/4HANA Financial Closing cockpit*: Beyond Closing
SAP S/4HANA
1709
SAP S/4HANA
Financial
Closing
cockpit
* Use cases described are valid with SAP FCc 2.0 as well.
27PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
28PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Smart Business for Financial Close
29PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

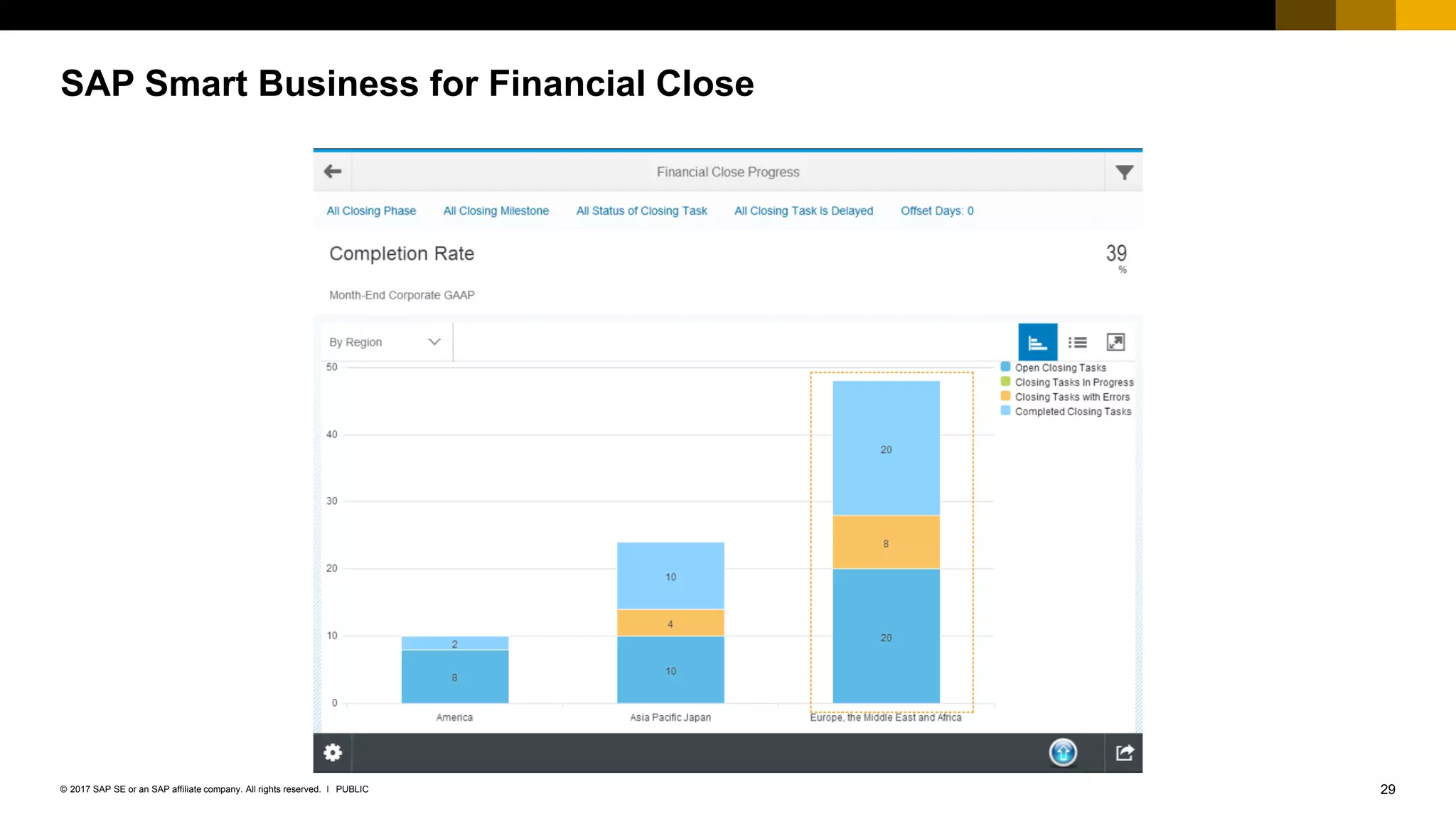

SAP Smart Business for Financial Close
30PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
 SAP Smart Business for Financial Close 1.0
offers monitoring and analytics apps on top of
SAP FCc. http://help.sap.com/ssb
 Included in the standard license
 Available with SAP ECC (requires SAP HANA)
and SAP S/4HANA Finance (aka “Simple
Finance add-on”) 1503 and 1605.
 Is an optional component to SAP FCc; not
intended to fully replace BW Content, no further
investments from SAP side.
SAP Smart Business for Financial Close
SAP S/4HANA
SAP Financial
Closing
cockpit
31PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Lumira for Financial Close
32PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Lumira for Financial Close
33PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

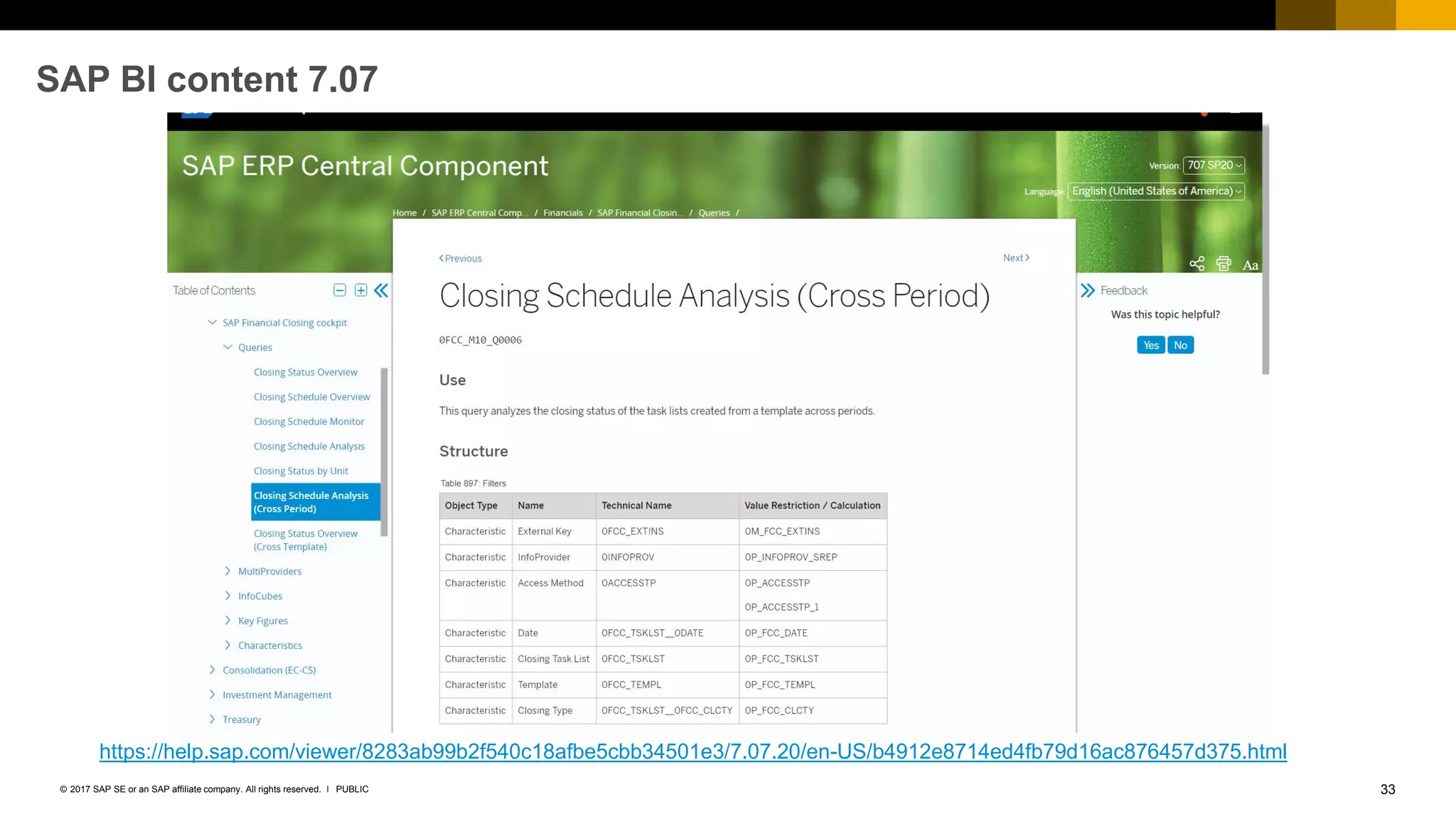

SAP BI content 7.07
https://help.sap.com/viewer/8283ab99b2f540c18afbe5cbb34501e3/7.07.20/en-US/b4912e8714ed4fb79d16ac876457d375.html
34PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
35PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

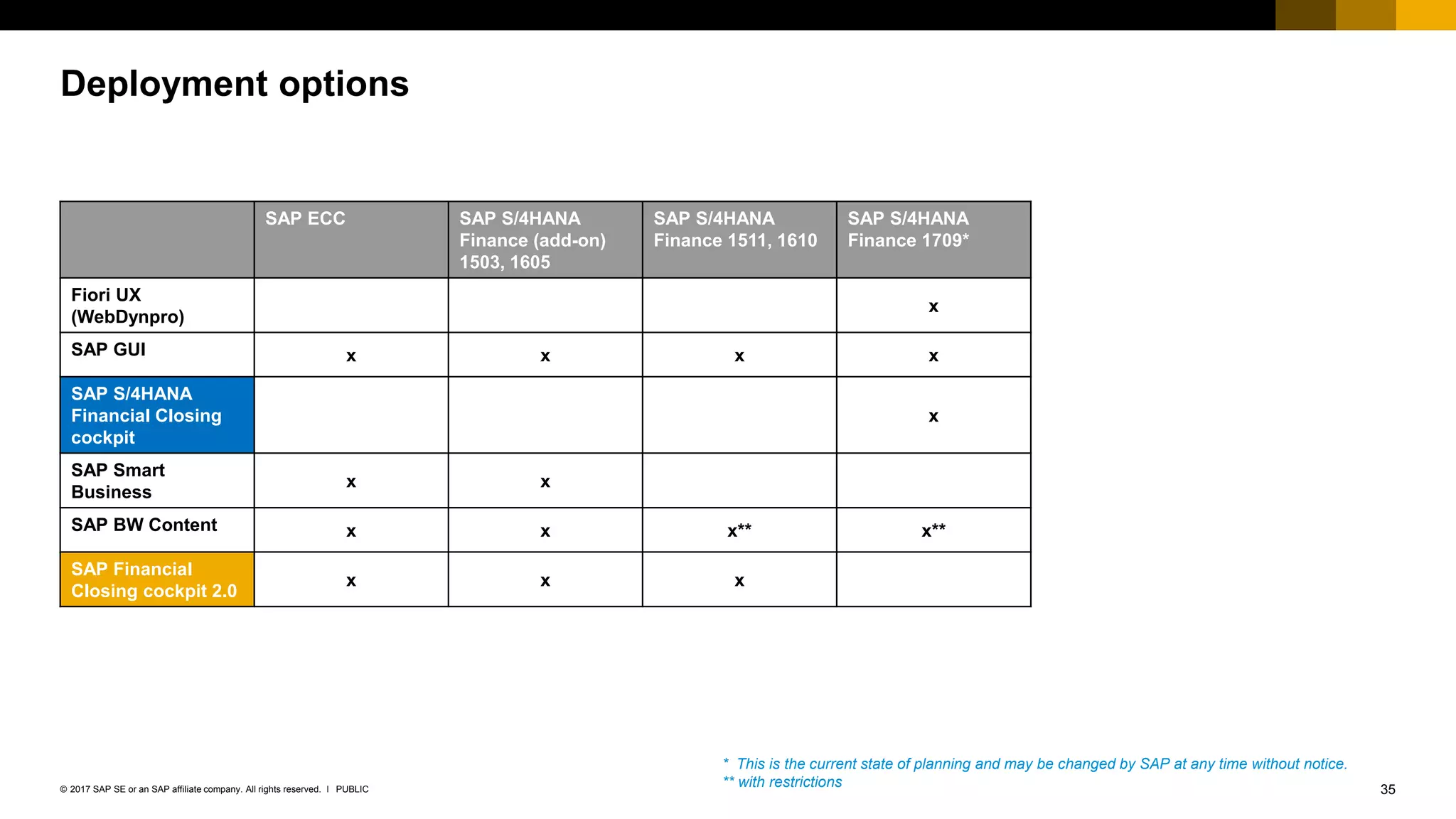

Deployment options
SAP ECC SAP S/4HANA
Finance (add-on)
1503, 1605
SAP S/4HANA
Finance 1511, 1610
SAP S/4HANA
Finance 1709*
Fiori UX
(WebDynpro)
x
SAP GUI x x x x
SAP S/4HANA
Financial Closing
cockpit
x
SAP Smart
Business
x x
SAP BW Content x x x** x**
SAP Financial
Closing cockpit 2.0
x x x
* This is the current state of planning and may be changed by SAP at any time without notice.
** with restrictions
36PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Financial Closing Cockpit
Analyze Execute
Entity Close
Management
Monitor
Plan
37PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP S/4HANA Financial Closing cockpit
38PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Financial Closing Cockpit
Entity Close
Management
Plan
39PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

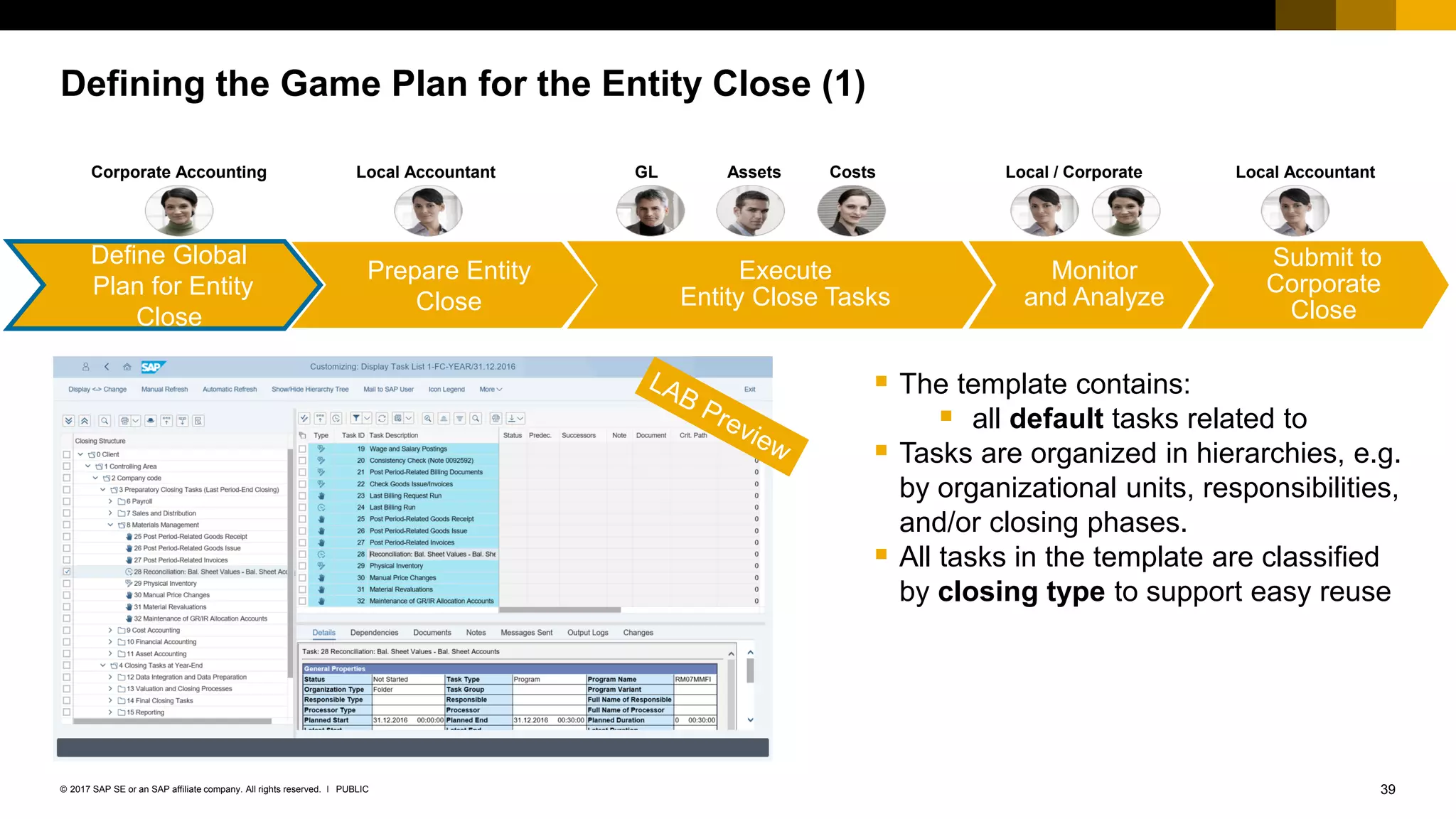

Defining the Game Plan for the Entity Close (1)
 The template contains:
 all default tasks related to
 Tasks are organized in hierarchies, e.g.
by organizational units, responsibilities,
and/or closing phases.
 All tasks in the template are classified
by closing type to support easy reuse
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Entity
Close
Local / Corporate Local Accountant
40PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

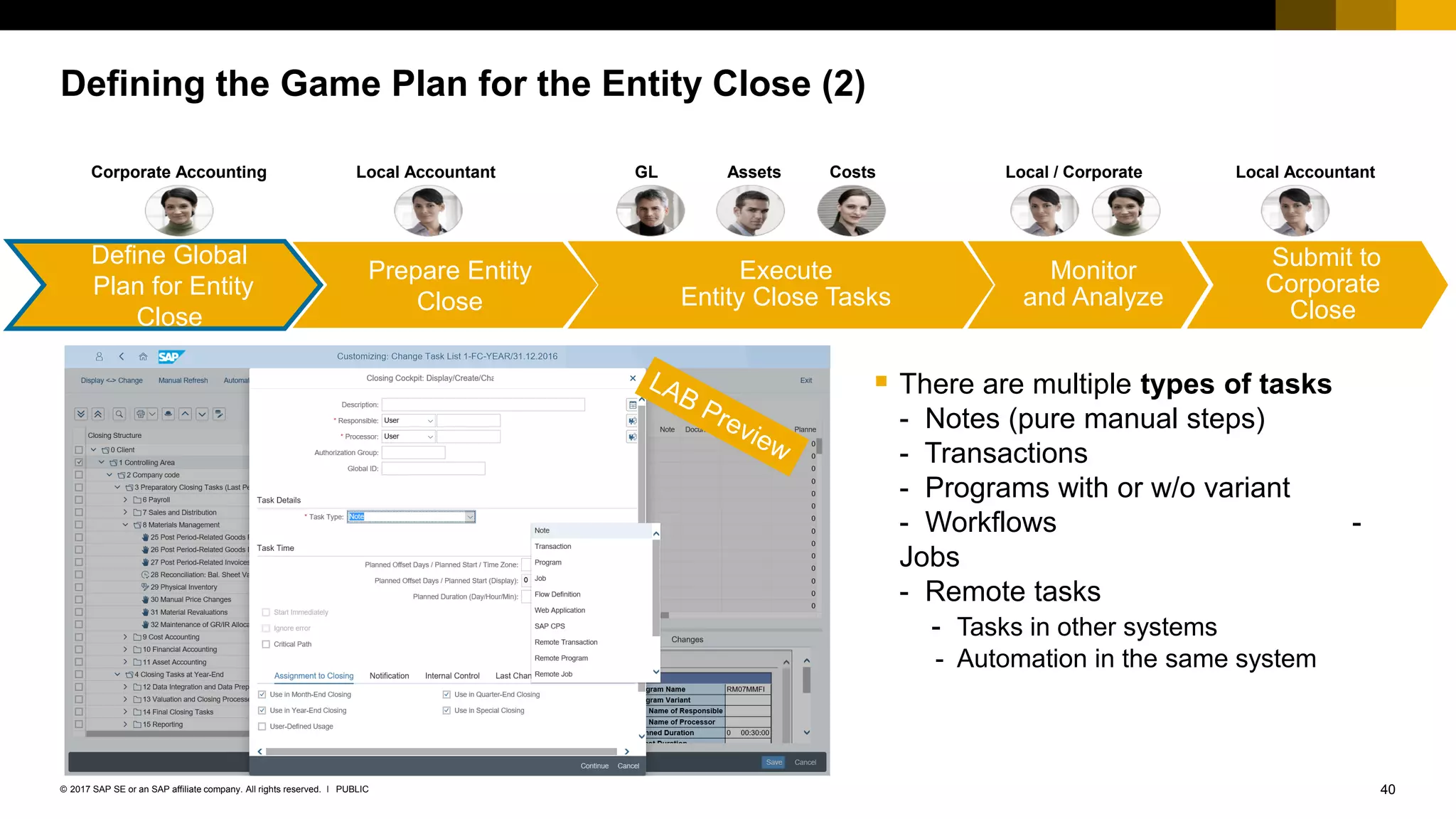

Defining the Game Plan for the Entity Close (2)
 There are multiple types of tasks
- Notes (pure manual steps)
- Transactions
- Programs with or w/o variant
- Workflows -
Jobs
- Remote tasks
- Tasks in other systems
- Automation in the same system
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Entity
Close
Local / Corporate Local Accountant
41PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

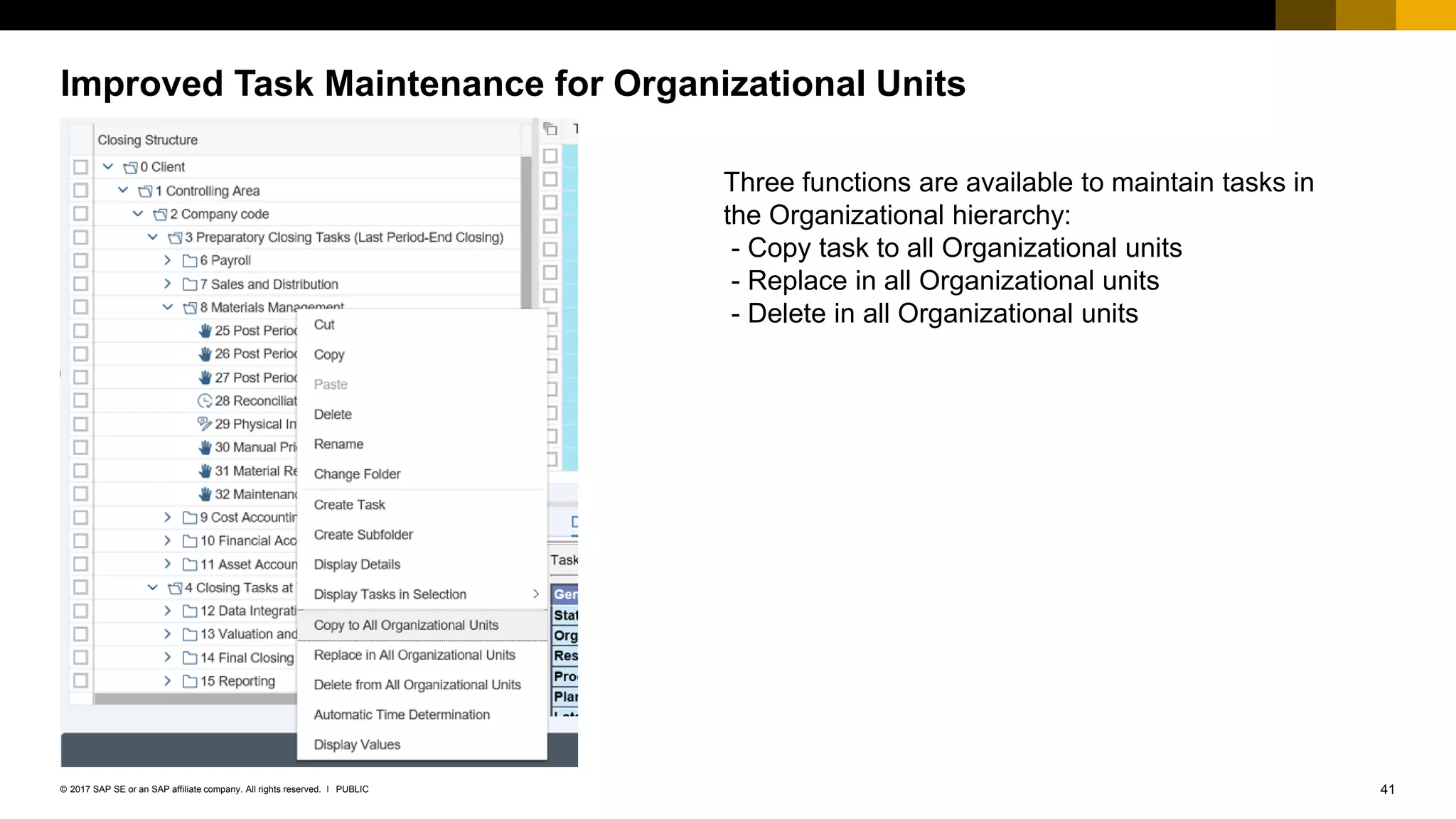

Improved Task Maintenance for Organizational Units
Three functions are available to maintain tasks in
the Organizational hierarchy:
- Copy task to all Organizational units
- Replace in all Organizational units
- Delete in all Organizational units
42PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

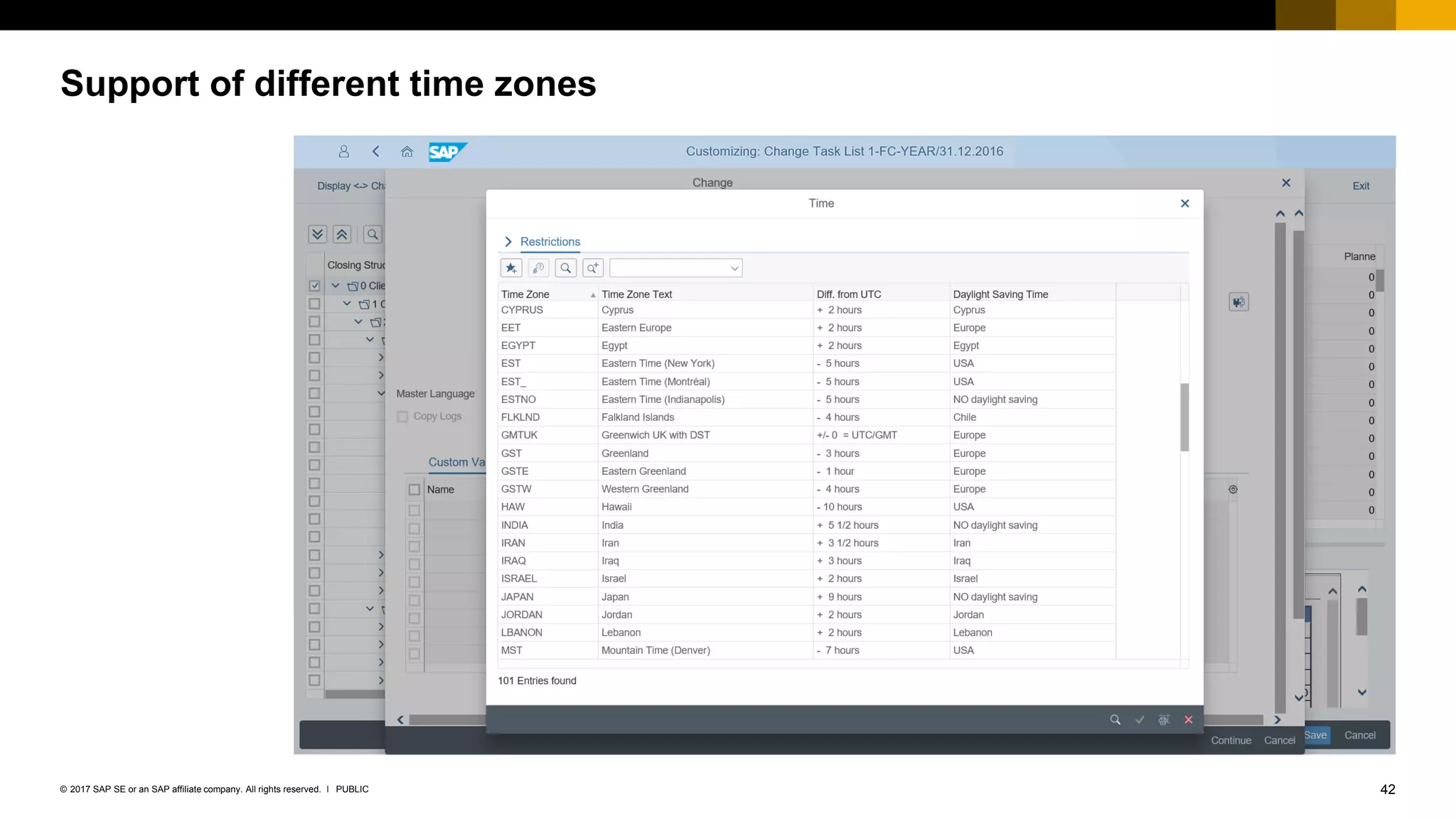

Support of different time zones
43PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Financial Closing Cockpit
Execute
Entity Close
Management
Plan
44PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

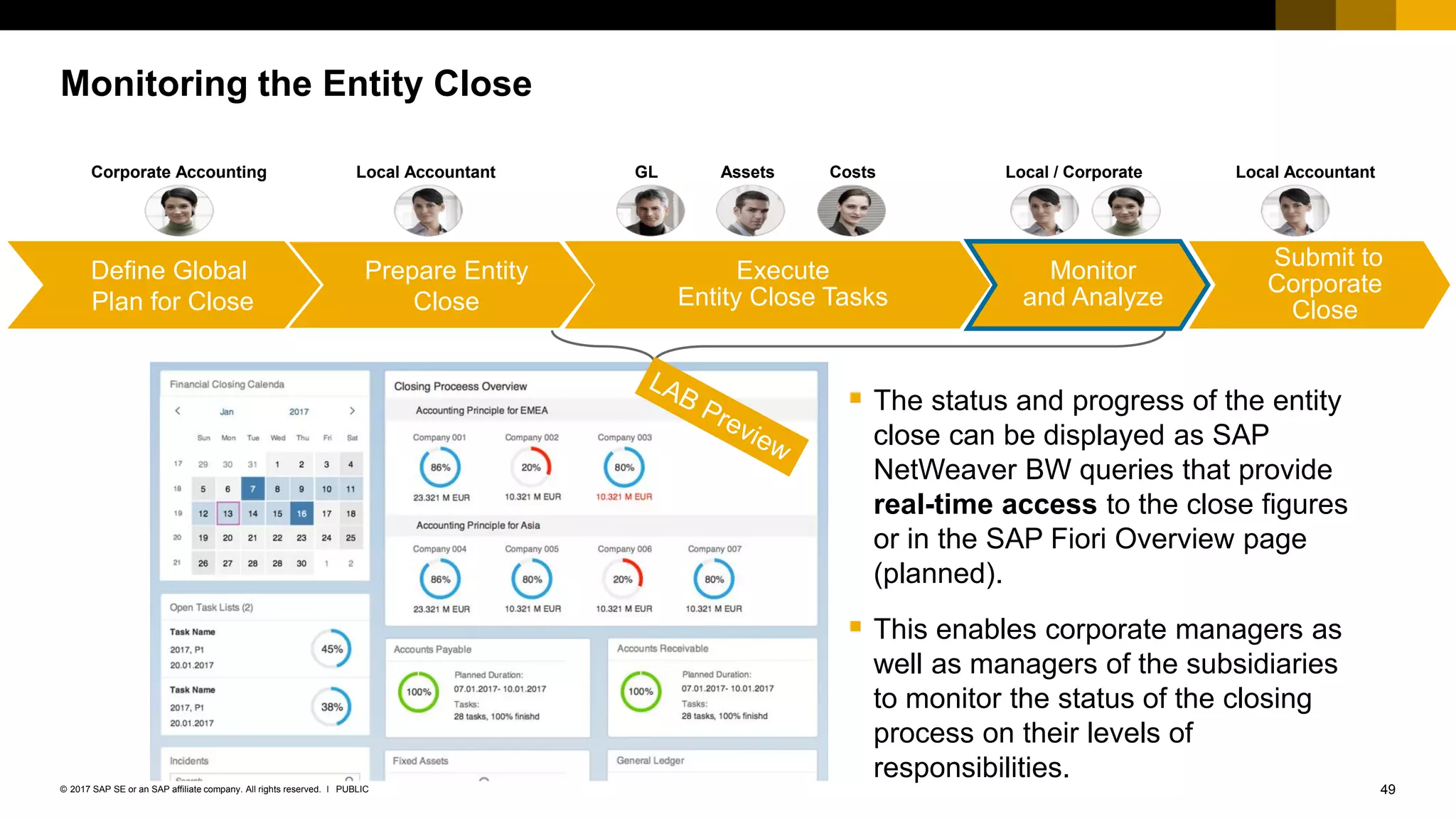

Preparing a Concrete Entity Close Cycle
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Entity
Close
Local / Corporate Local Accountant
 The task list contains all tasks related
to a concrete close cycle and the
absolute schedule for the tasks.
 The task list is generated from the
template and adjusted according to
the concrete closing cycle of the
subsidiary.
 Generation of task lists can even be
organized under corporate
responsibility to ensure a harmonized
closing process across subsidiaries.
45PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

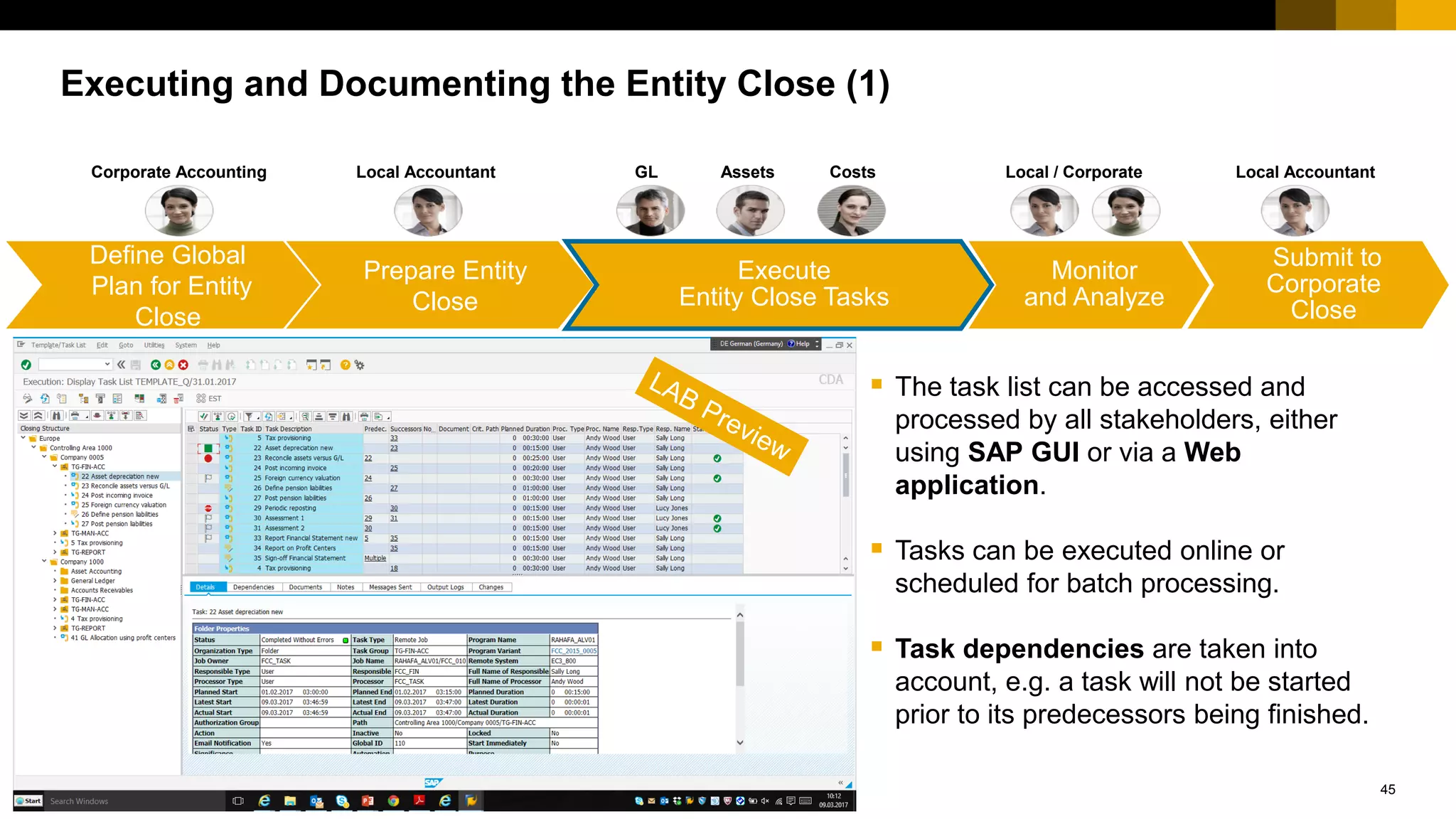

Executing and Documenting the Entity Close (1)
 The task list can be accessed and
processed by all stakeholders, either
using SAP GUI or via a Web
application.
 Tasks can be executed online or
scheduled for batch processing.
 Task dependencies are taken into
account, e.g. a task will not be started
prior to its predecessors being finished.
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Entity
Close
Local / Corporate Local Accountant
46PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

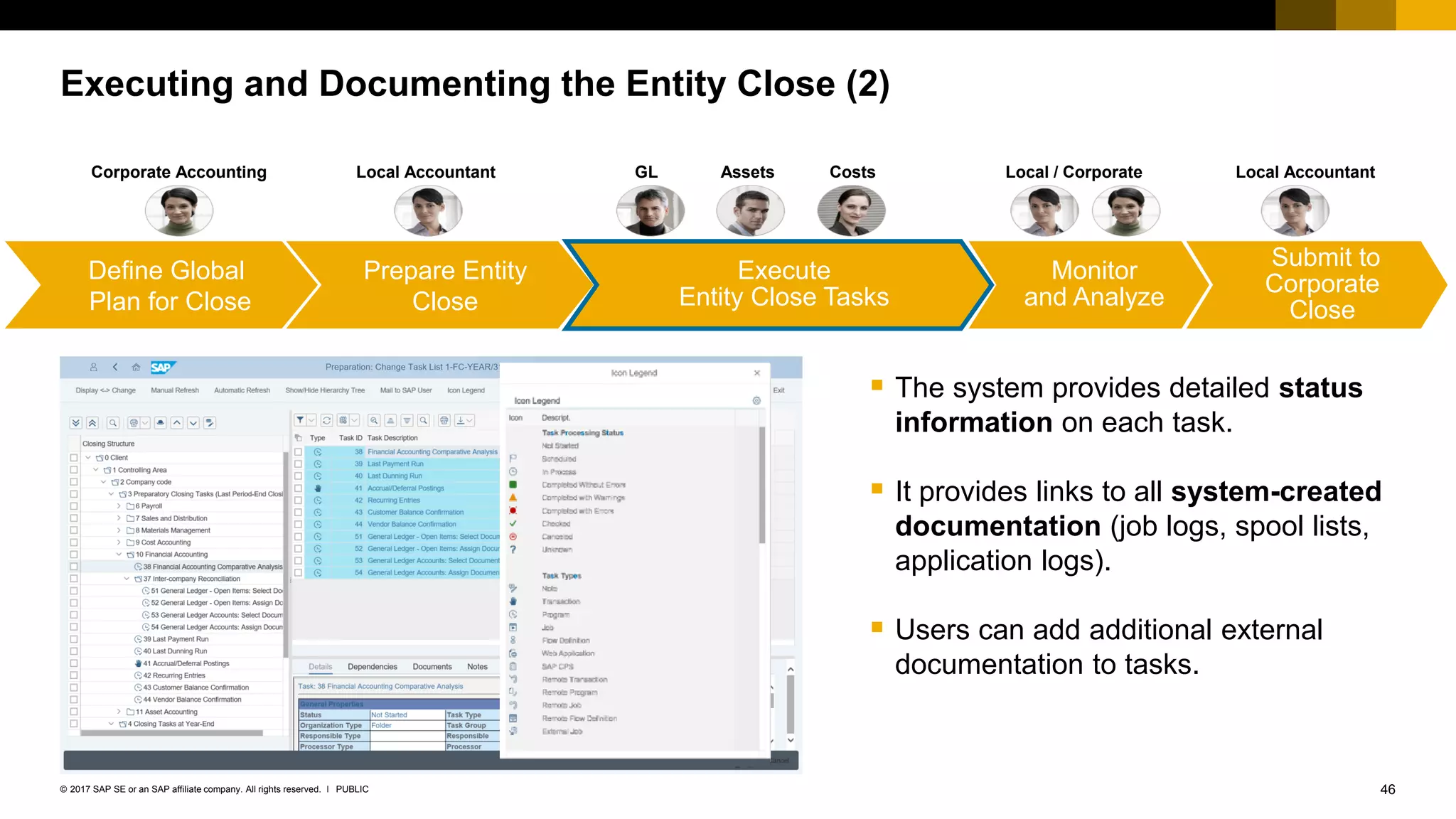

Executing and Documenting the Entity Close (2)
 The system provides detailed status
information on each task.
 It provides links to all system-created
documentation (job logs, spool lists,
application logs).
 Users can add additional external
documentation to tasks.
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Close
Local / Corporate Local Accountant
47PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

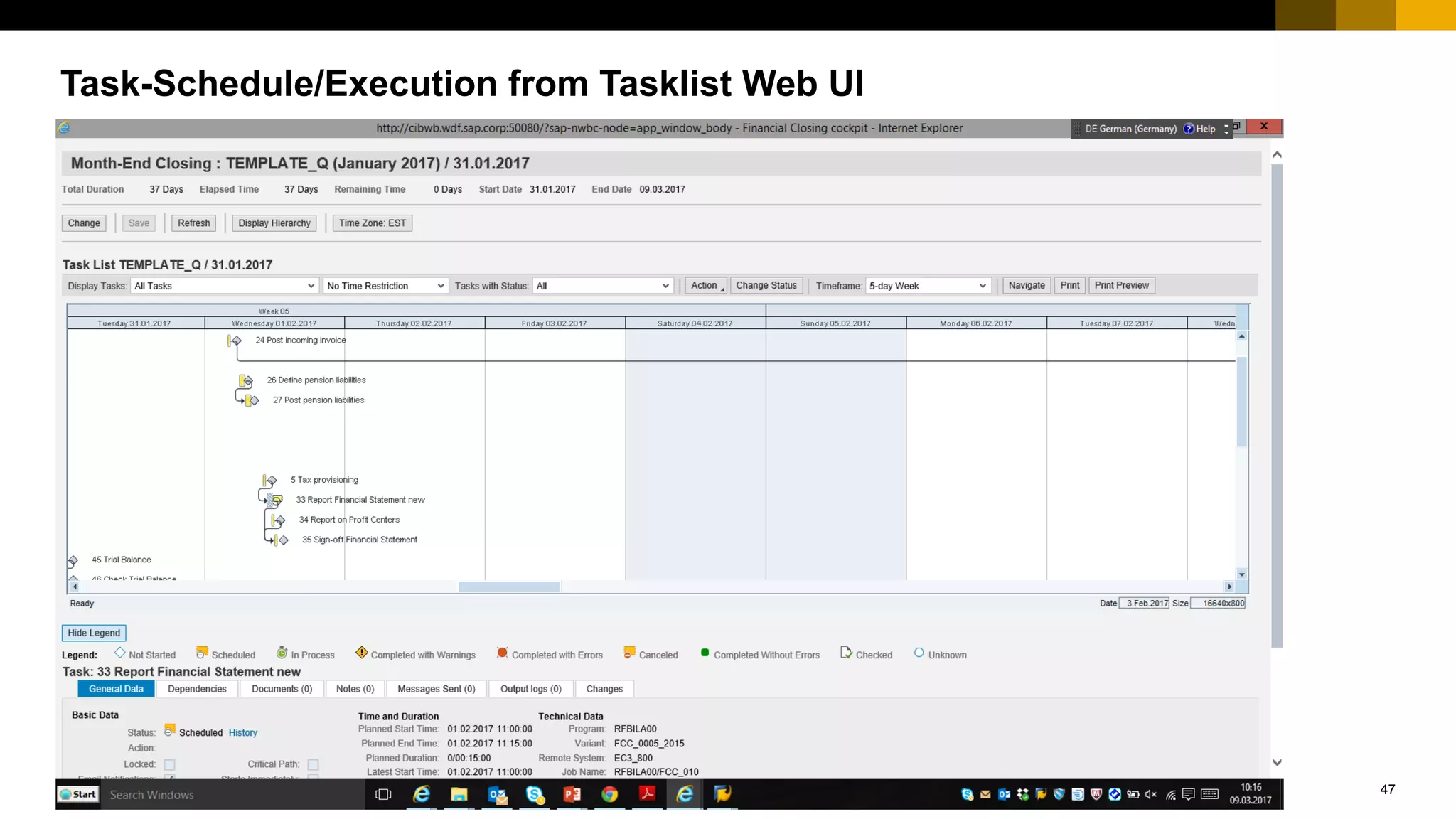

Task-Schedule/Execution from Tasklist Web UI
48PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Financial Closing Cockpit
Execute
Entity Close
Management
Monitor
Plan
49PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Monitoring the Entity Close
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Close
Local / Corporate Local Accountant
 The status and progress of the entity
close can be displayed as SAP
NetWeaver BW queries that provide
real-time access to the close figures
or in the SAP Fiori Overview page
(planned).
 This enables corporate managers as
well as managers of the subsidiaries
to monitor the status of the closing
process on their levels of
responsibilities.
50PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

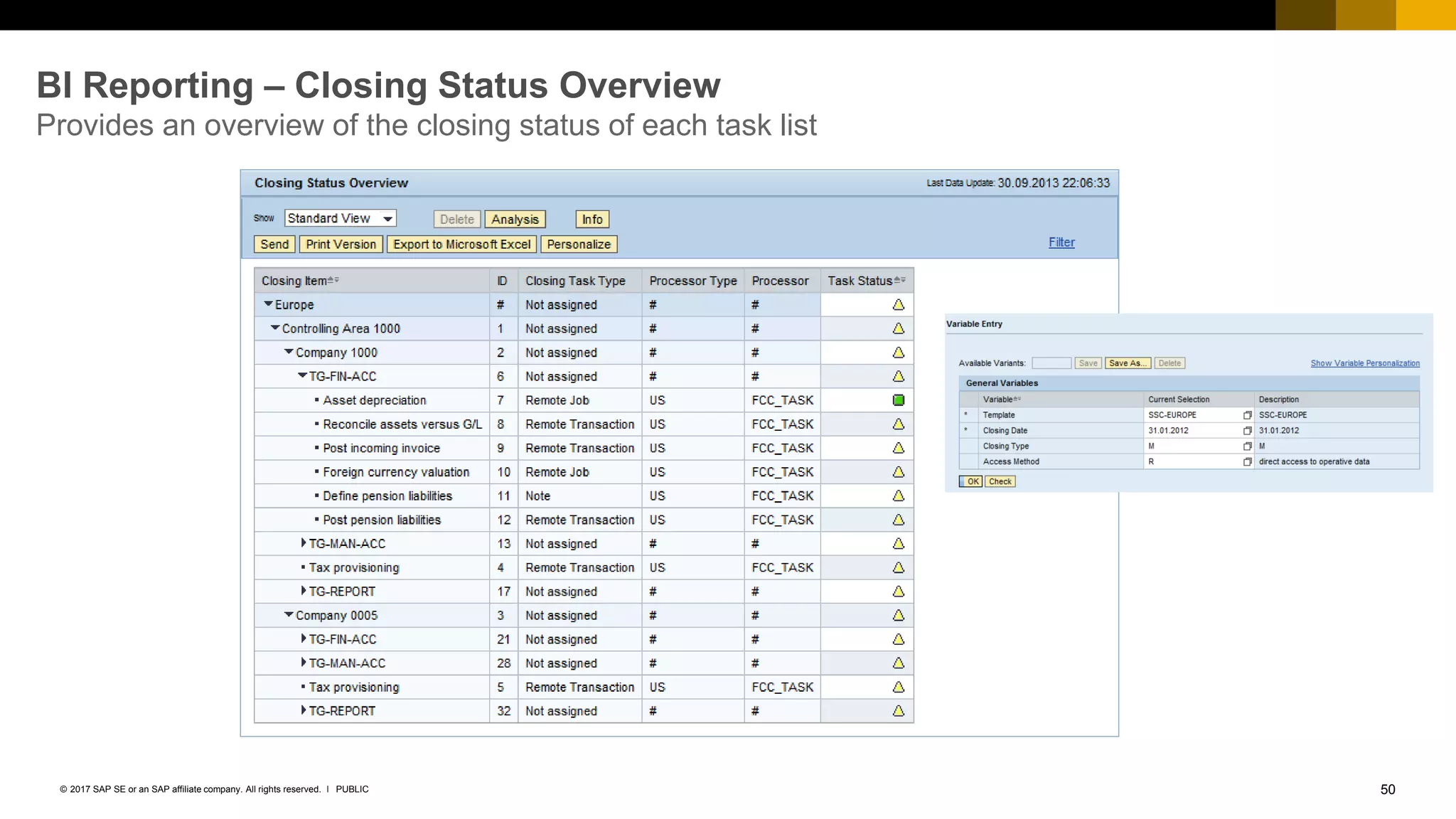

BI Reporting – Closing Status Overview
Provides an overview of the closing status of each task list
51PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

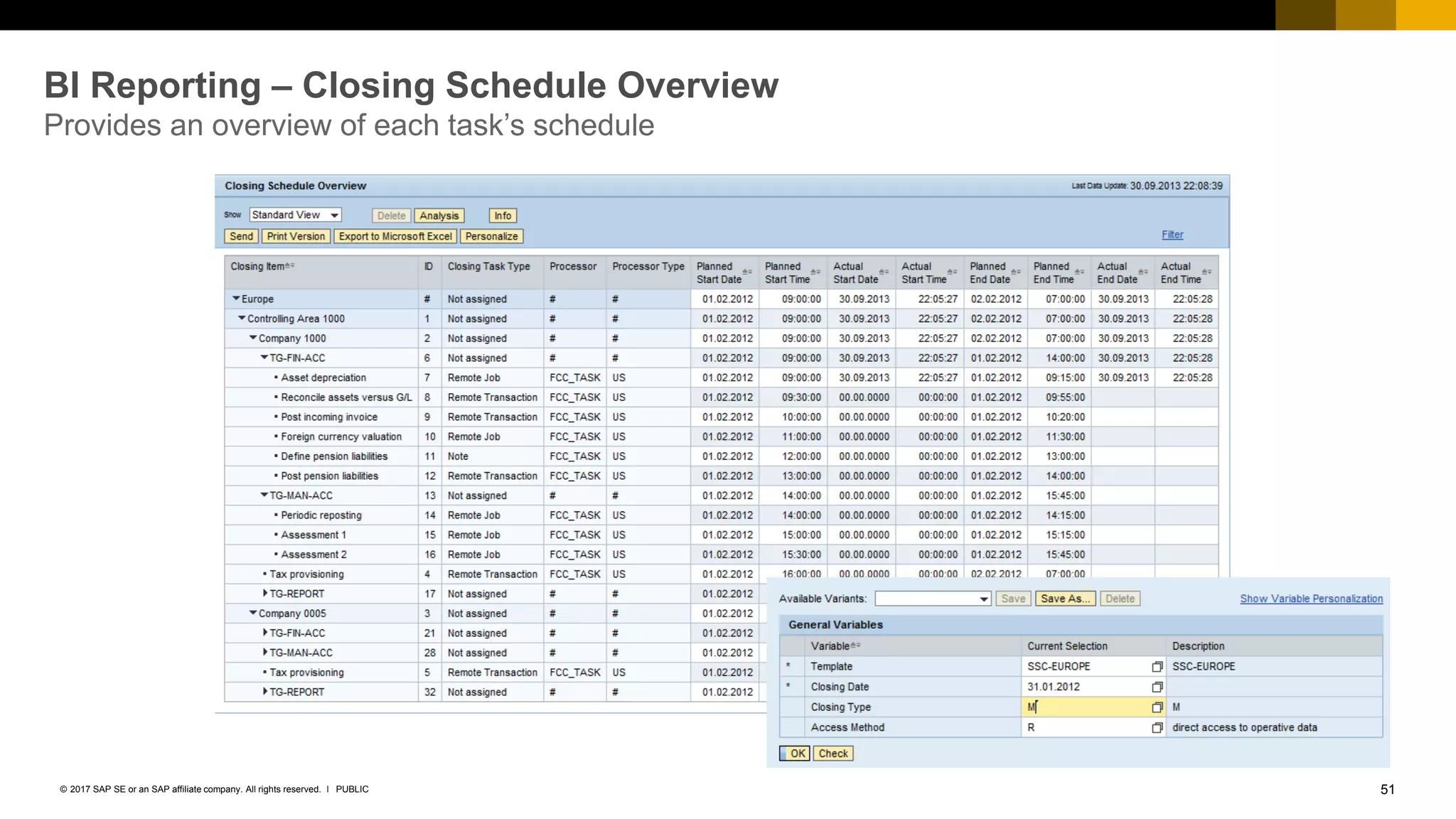

BI Reporting – Closing Schedule Overview
Provides an overview of each task’s schedule
52PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP S/4HANA Financial Closing Cockpit
Analyze Execute
Entity Close
Management
Monitor
Plan
53PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Analyzing and Continually Improving the Entity Close
Gain insightOptimize
Prepare Entity
Close
*
GL
Submit to
Corporate
Close
Assets CostsCorporate Accounting Local Accountant
Execute
Entity Close Tasks
Monitor
and Analyze
Define Global
Plan for Close
Local / Corporate Local Accountant
 The actual duration of the tasks
in a single close can be
compared with the planned
duration using an SAP
NetWeaver BW query or SAP
Fiori (Planned).
 This enables the user to
improve the template based on
clear insights for the next
closing cycle.
54PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
BI Reporting – Closing Schedule Analysis
Analyses the tasks’ completion status
55PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

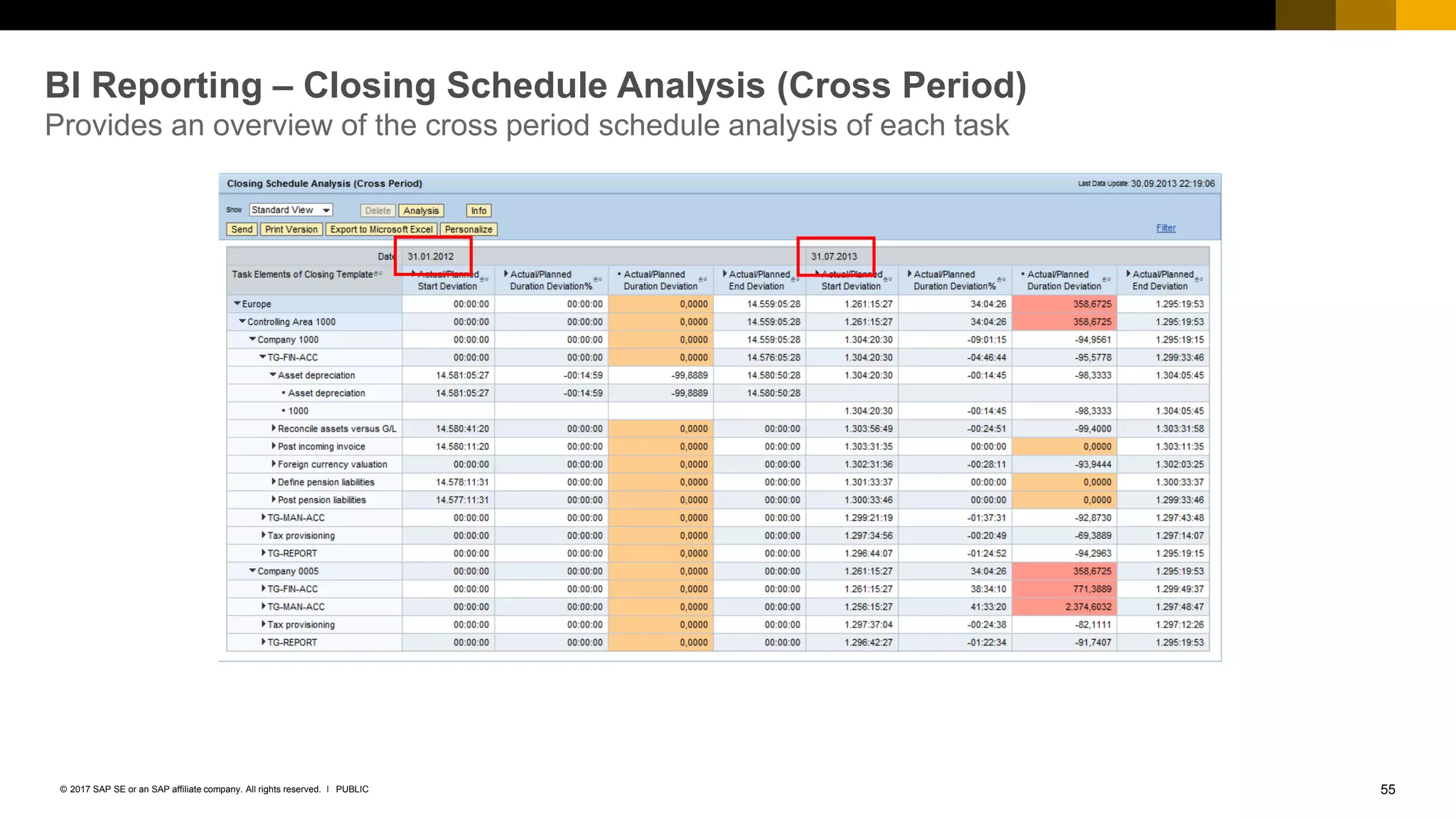

BI Reporting – Closing Schedule Analysis (Cross Period)
Provides an overview of the cross period schedule analysis of each task
56PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

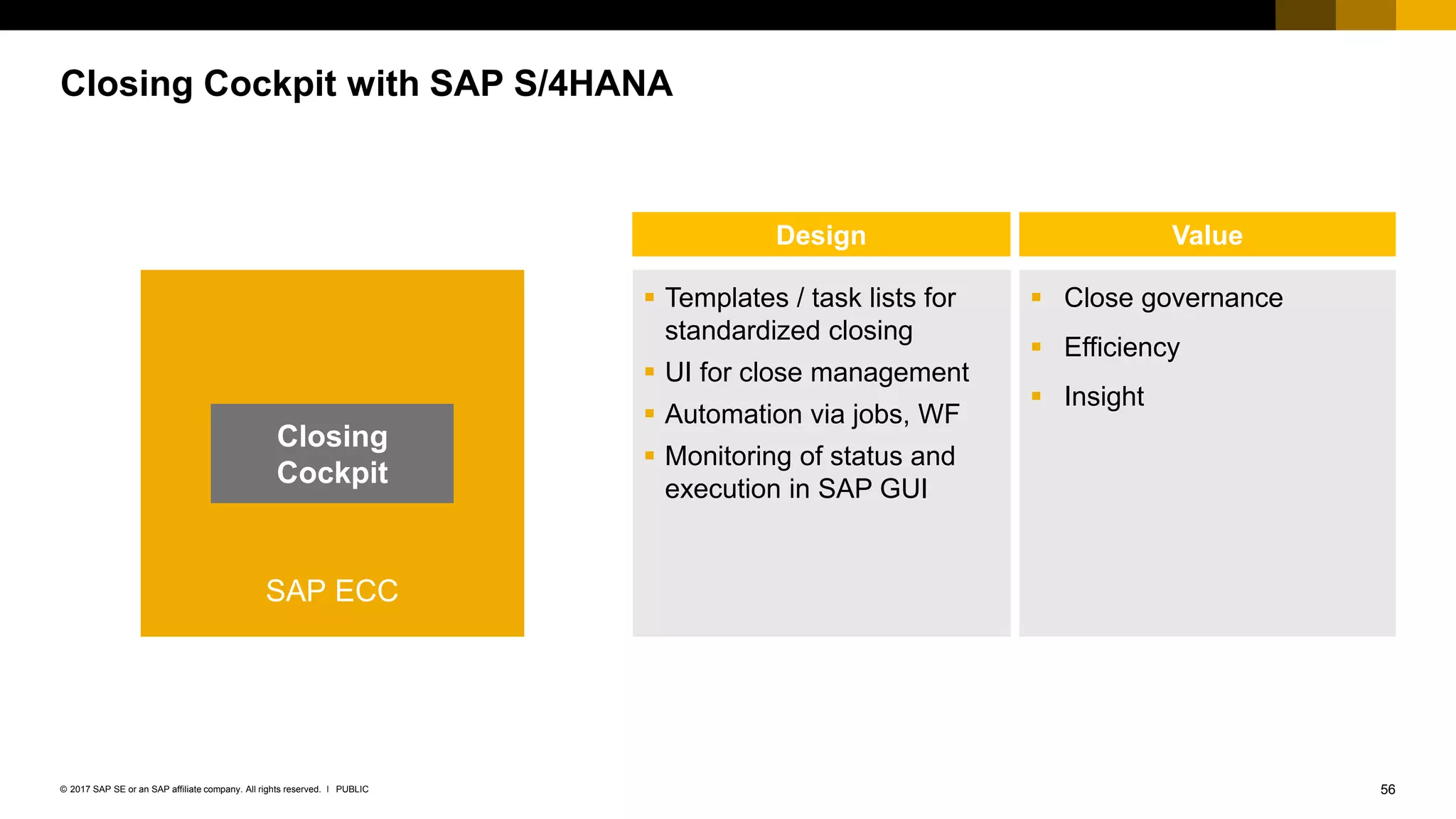

Closing Cockpit with SAP S/4HANA
SAP ECC
Closing
Cockpit
 Close governance
 Efficiency
 Insight
 Templates / task lists for
standardized closing
 UI for close management
 Automation via jobs, WF
 Monitoring of status and
execution in SAP GUI
Design Value
57PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ

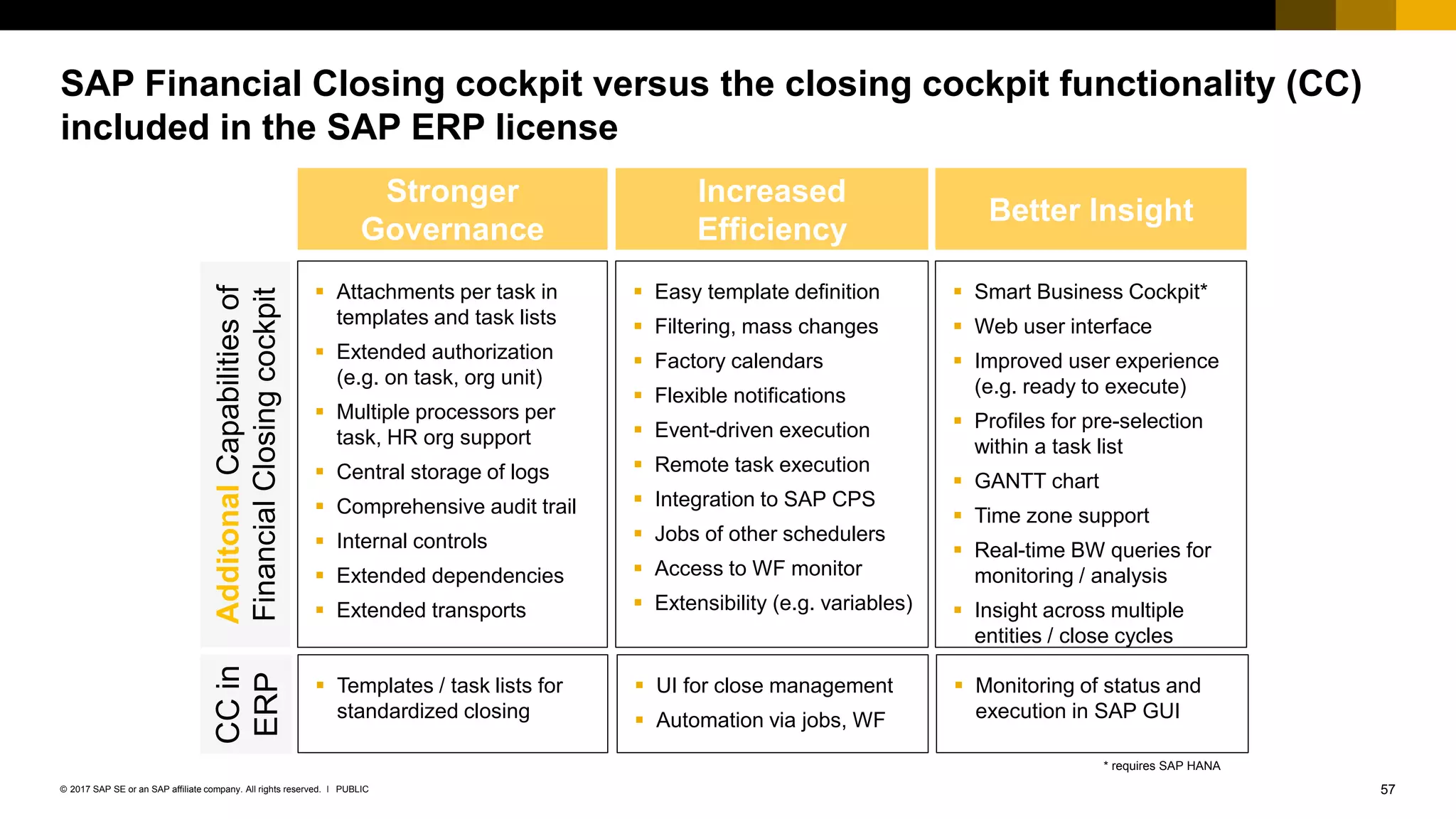

SAP Financial Closing cockpit versus the closing cockpit functionality (CC)
included in the SAP ERP license
Stronger
Governance
Increased
Efficiency
Better Insight
 Attachments per task in
templates and task lists
 Extended authorization
(e.g. on task, org unit)
 Multiple processors per
task, HR org support
 Central storage of logs
 Comprehensive audit trail
 Internal controls
 Extended dependencies
 Extended transports
 Easy template definition
 Filtering, mass changes
 Factory calendars
 Flexible notifications
 Event-driven execution
 Remote task execution
 Integration to SAP CPS
 Jobs of other schedulers
 Access to WF monitor
 Extensibility (e.g. variables)
 Smart Business Cockpit*
 Web user interface
 Improved user experience
(e.g. ready to execute)
 Profiles for pre-selection
within a task list
 GANTT chart
 Time zone support
 Real-time BW queries for
monitoring / analysis
 Insight across multiple
entities / close cycles
 Templates / task lists for
standardized closing
CCin
ERP
AdditonalCapabilitiesof
FinancialClosingcockpit
 UI for close management
 Automation via jobs, WF
 Monitoring of status and
execution in SAP GUI
* requires SAP HANA
58PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Closing Cockpit with SAP S/4HANA
SAP ECC
Closing
Cockpit
SAP S/4HANA
Closing
Cockpit
59PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Customers who use the Closing Cockpit in
ECC can continue to use the Closing Cockpit
in SAP S/4HANA.
NOTE: 2332547 - S4TWL - Closing Cockpit with S/4HANA OP
The functionality of the standard Closing cockpit (without license) is
available, but defined as "not the target architecture" in SAP
S/4HANA 1511, 1610 or subsequent releases. See SAP note
2269324 – Compatibility Scope Matrix for SAP S/4HANA, on-
premise edition. Thus transaction codes CLOCO, CLOCOC and
CLOCOS are supported but are part of compatibility scope in
S/4HANA OP. The Business Functions FIN_ACC_LOCAL_CLOSE,
FIN_ACC_LOCAL_CLOSE_2, FIN_ACC_LOCAL_CLOSE_3
(requiring a license for SAP Financial Closing cockpit) are flagged
as obsolete in S/4HANA OP.
If any of the Business Functions listed above are active, consider to
use the Add-On Financials Closing Cockpit 2.0 instead.
https://launchpad.support.sap.com/#/notes/2332547
Closing Cockpit with SAP S/4HANA: Detail
SAP S/4HANA
Closing
Cockpit
60PUBLIC© 2017 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
SAP Financial Closing
cockpit (SAP FCc)
 Overview
 Status
SAP S/4HANA Financial
Closing cockpit
 Roadmap
 SAP S/4HANA 1709
 Outlook into the Cloud
Use cases
 Central Close
 SAP Shared Service Framework and SAP S/4HANA FCc
 SAP Process Control and SAP S/4HANA FCc
 Beyond Closing
Analytics
 SAP FCc Analytics with SAP Smart Business
 SAP FCc Analytics with SAP Lumira
 SAP BI Content
Additional Information
 Availability options
 Key Capabilities (SAP FCc process)
 Closing cockpit
What do you think?
Contact:
Dr. Christoph Ernst
Senior Director
Finance Solutions
SAP SE
+49 160 9081 9609
Christoph.Ernst@sap.com
No part of this publication may be reproduced or transmitted in any form or for any purpose without the express permission of SAP SE or an SAP affiliate company.
The information contained herein may be changed without prior notice. Some software products marketed by SAP SE and its distributors contain proprietary software components
of other software vendors. National product specifications may vary.
These materials are provided by SAP SE or an SAP affiliate company for informational purposes only, without representation or warranty of any kind, and SAP or its affiliated
companies shall not be liable for errors or omissions with respect to the materials. The only warranties for SAP or SAP affiliate company products and services are those that are
set forth in the express warranty statements accompanying such products and services, if any. Nothing herein should be construed as constituting an additional warranty.
In particular, SAP SE or its affiliated companies have no obligation to pursue any course of business outlined in this document or any related presentation, or to develop or release
any functionality mentioned therein. This document, or any related presentation, and SAP SE’s or its affiliated companies’ strategy and possible future developments, products,
and/or platform directions and functionality are all subject to change and may be changed by SAP SE or its affiliated companies at any time for any reason without notice. The
information in this document is not a commitment, promise, or legal obligation to deliver any material, code, or functionality. All forward-looking statements are subject to various
risks and uncertainties that could cause actual results to differ materially from expectations. Readers are cautioned not to place undue reliance on these forward-looking statements,
and they should not be relied upon in making purchasing decisions.
SAP and other SAP products and services mentioned herein as well as their respective logos are trademarks or registered trademarks of SAP SE (or an SAP affiliate company)
in Germany and other countries. All other product and service names mentioned are the trademarks of their respective companies.
See http://global.sap.com/corporate-en/legal/copyright/index.epx for additional trademark information and notices.
© 2017 SAP SE or an SAP affiliate company. All rights reserved.

SAP Financial Closing cockpit in SAP S/4HANA; status and Roadmap

  • 1.
    PUBLIC Christoph Ernst, SAP July,2017 SAP Financial Closing cockpit in SAP S/4HANA Status and Roadmap
  • 2.
    2PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ The information in this presentation is confidential and proprietary to SAP and may not be disclosed without the permission of SAP. Except for your obligation to protect confidential information, this presentation is not subject to your license agreement or any other service or subscription agreement with SAP. SAP has no obligation to pursue any course of business outlined in this presentation or any related document, or to develop or release any functionality mentioned therein. This presentation, or any related document and SAP's strategy and possible future developments, products and or platforms directions and functionality are all subject to change and may be changed by SAP at any time for any reason without notice. The information in this presentation is not a commitment, promise or legal obligation to deliver any material, code or functionality. This presentation is provided without a warranty of any kind, either express or implied, including but not limited to, the implied warranties of merchantability, fitness for a particular purpose, or non-infringement. This presentation is for informational purposes and may not be incorporated into a contract. SAP assumes no responsibility for errors or omissions in this presentation, except if such damages were caused by SAP’s intentional or gross negligence. All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, which speak only as of their dates, and they should not be relied upon in making purchasing decisions. Disclaimer
  • 3.
    3PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 4.
    4PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 5.
    5PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing cockpit with SAP ECC SAP ECC SAP Financial Closing cockpit  Faster close  Stricter Close governance  Less effort and cost  Increased Compliance  Improved data quality  Less errors  Higher transparency  Central planning, execution and monitoring of all close activities in all areas  Templates for process steps of entities  Documentation of status Design Value
  • 6.
    6PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing cockpit with SAP S/4HANA SAP ECC SAP S/4HANA 1511, 1610 SAP Financial Closing cockpit SAP Financial Closing cockpit
  • 7.
    7PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ  Customers who use the SAP Financial Closing cockpit in ECC can continue to use the SAP Financial Closing Cockpit in SAP S/4HANA.  Customers can start using SAP Financial Closing cockpit with SAP S/4HANA 1511 or 1610 as well.  SAP Financial Closing cockpit = Transactions codes „FCLOCOx“  However, SAP Financial Closing cockpit remains part of the compatibility scope matrix (since the list should remain stable; note: 2269324) SAP Financial Closing cockpit with SAP S/4HANA: Detail SAP S/4HANA 1511, 1610 SAP Financial Closing cockpit
  • 8.
    8PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Existing SAP Financial Closing cockpit can also work with other scheduling solutions than Redwood (note: 2391918) Business Automation Enabler (BAE) is an interface between SAP Financial Closing Cockpit and External Scheduling Tools like SAP Central Process Scheduler (CPS) for scheduling jobs and job chains and integrating of business and infrastructure events. Before 01.11.2016 the usage of this interface was restricted to SAP BPA and SAP CPS only. Starting from 01.11.2016 it was released for all external schedulers that have passed either the SMSE or the BAE certification procedure. UC4 Automic, Redwood Cronacle, IBM Tivoli, CA Workload Automation, Honico Batchman, SAP BPA, SAP CPS SAP Financial Closing cockpit: open to various scheduling solutions SAP ECC/SAP S/4HANA SAP Financial Closing cockpit
  • 9.
    9PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 10.
    10PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Perfect Planning, Automation and Monitoring – SAP S/4HANA Financial Closing cockpit Benefits Faster Entity Close through improved closing efficiency Governance and Compliance Transparency and Insight 15-25% Faster Closing cycle – while ensuring high quality compliant results Source: SAP Performance Benchmarking Capabilities Automated closing tasks, even in remote systems and powerful, user-friendly application for manual tasks Collaboration, notifications, and workflows Define a global game plan for the entity close; leverage it for multiple org units and closing cycles Audit trail, logging, documentation Real-time insight into the closing status Monitoring by subsidiaries and headquarter Close Analysis * This is the current state of planning and may be changed by SAP at any time without notice.
  • 11.
    11PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Planned innovations: SAP S/4HANA 1709 Focus: provide SAP S/4HANA on premise customers with SAP FCc  part of SAP S/4HANA Core (no add-on anymore) with comparable functionality as add-on  Fioritized UX (on the basis of existing transactions) Product vision: Intelligent Financial Closing cockpit on SAP Cloud Platform Focus: cloud, automation, machine learning and analytics  Cloud: Flexible deployment option, connectivity to on premise and cloud  Automation: Scheduling or processing of closing tasks in due sequence with complete audit trail for status changes, incidents and relevant result objects; approval workflow for specific tasks  Machine Learning: leverage existing and planned Apps like GR/IR, Intercompany, Accruals, Matching, Reconciliation  Analytics: Financial Close KPI Overview SAP S/4HANA Financial Closing cockpit – Roadmap* * This is the current state of planning and may be changed by SAP at any time without notice. Mus ter Mus ter Mus ter Mus ter
  • 12.
    12PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ  SAP FCc is planned to become a core part of SAP S/4HANA 1709 (as opposed to being an add-on to ECC/SAP S/4HANA 1610) with automatic technical transition for existing SAP FCc customers.  SAP FCc is planned to come with a new and renovated UX (Fiori) – current capabilities remain.  SAP FCc remains to be a separate license. Existing licenses will be credited.  It comes with a new SAP S/4HANA material number (outside Compatibility Pack), however keeping the same metric. 7019413 SAP S/4HANA Financial Closing cockpit 8005543 Cloud (HEC) SAP S/4HANA Financial Closing cockpit ► Reliable path into the future for existing and new customers of SAP FCc Planned innovation*: SAP S/4HANA Financial Closing cockpit with SAP S/4HANA 1709 SAP S/4HANA 1709 SAP S/4HANA Financial Closing cockpit * This is the current state of planning and may be changed by SAP at any time without notice.
  • 13.
    13PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Planned innovation*: SAP S/4HANA Financial Closing cockpit with SAP S/4HANA 1709 Muster Muster Muster Muster * This is the current state of planning and may be changed by SAP at any time without notice.
  • 14.
    14PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Intelligent Financial Closing cockpit SAP Cloud Platform SAP S/4HANA Product Vision*: SAP Intelligent Financial Closing cockpit Integration with SAP Cloud Platform extension approach Focus: cloud, automation, machine learning and analytics  Cloud: Flexible deployment option, connectivity to on premise and cloud  Automation: Scheduling or processing of closing tasks in due sequence with complete audit trail for status changes, incidents and relevant result objects; approval workflow for specific tasks  Machine Learning: leverage existing and planned Apps like GR/IR, Intercompany, Accruals, Matching, Reconciliation  Analytics: Financial Close KPI Overview SAP ERP SAP S/4HANA Cloud * This is the current state of planning and may be changed by SAP at any time without notice.
  • 15.
    15PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Product Vision*: SAP Intelligent Financial Closing cockpit Integration with SAP Cloud Platform extension approach * This is the current state of planning and may be changed by SAP at any time without notice.
  • 16.
    16PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Product Vision*: SAP Intelligent Financial Closing cockpit Integration with SAP Cloud Platform extension approach * This is the current state of planning and may be changed by SAP at any time without notice.
  • 17.
    17PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Product Vision*: SAP Intelligent Financial Closing cockpit Integration with SAP Cloud Platform extension approach * This is the current state of planning and may be changed by SAP at any time without notice.
  • 18.
    18PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 19.
    19PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing cockpit SAP S/4HANA Central Close with SAP Financial Closing cockpit in heterogenous landscapes  One technical installation of SAP Financial Closing cockpit (on SAP ERP, SAP S/4HANA, or SAP BW), connected with the entity systems, can be set up to centrally manage the respective closing tasks in various source-systems.  SAP Financial Closing cockpit can also be technically installed on a SAP Central Finance instance. However, it is not required to replicate the entity data into the Central Finance instance – the SAP Financial Closing cockpit can perfectly work remotely, no need for data replication.  To allow for scheduling and monitoring tasks in Non-SAP environment, SAP Business Process Automation by Redwood is necessary; in an SAP environment it is not. SAP ERP Non-SAP
  • 20.
    20PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Shared Service Framework Introducing a new world of Digital Finance SAP Shared Service Framework enables Shared Service Organizations to increase the efficiency of their operations  Provides a central working environment for the entire shared service organization  Integrates deeply along all financial End-to- End processes  Streamlines and automates processes  Hides the complexity of typical shared service organization landscapes to the end- users
  • 21.
    21PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP‘s Service Management Platform Providing state-of-the-art Service Management Capabilities  Supporting a broad set of communication channels  Sophisticated Case Management functionalities  Complete transparency on Service Level Agreements  Clear responsibilities for efficient service execution and delivery  Increased transparency with embedded Service Analytics SAP Shared Service Framework Service center management Communication management Service delivery Service routing Analytics Governance and compliance
  • 22.
    22PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Planning the Implementation of SAP Enablers Simplifying the Patterns of Shared Service Delivery Service execution Request Feedback A. Communication Service execution B. Exception Handling Business Process C. End-2-End Process Management Service Execution
  • 23.
    23PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Shared Service Framework SAP Shared Service Framework Deeply integrated out-of-the-box into SAP’s Finance Solution Portfolio Integrated out-of-the-box with SAP end-to- end automation engines For example:  Optimized Accounts Receivable Process with Integrated collection and dispute worklists with SSF and the SAP Receivables Management solutions  Simplified communication and automated execution of the Closing Process with SSF and SAP Financial Closing Cockpit  Enhanced issue resolution capabilities in Accounts Payable with SSF and SAP Invoice Management by Open Text ..and many more… Accounts Receivable Closing Process And many more Accounts Payables
  • 24.
    24PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Support decisions and promote accountability with insightful analytics and sign-off Perform automated, exception-based monitoring of ERP systems Evaluate control design and effectiveness; raise and remediate issues Perform periodic risk assessments to determine scope and test strategies Document controls and policies centrally; map to key regulations and impacted organizations SAP Process Control Ensure effective controls and on-going compliance
  • 25.
    25PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Process Control SAP Process Control and SAP Financial Closing* cockpit SAP S/4HANA 1709 SAP S/4HANA Financial Closing cockpit  It may be usefull to include results of internal control monitoring with SAP Process Control into status overview in SAP FCc (on project basis)  Documentation and archiving of results can be performed in SAP FCc as well. * Use cases described are valid with SAP FCc 2.0 as well.
  • 26.
    26PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP FCc is not only about Closing: Whenever system related tasks have to be carried out, steps or results have to be docmented and/or collaborative work needs to be supported, SAP FCc capabilities are ready to support.  Customers use SAP FCc for example to plan, monitor and execute daily routines like payment and dunning runs.  Often general, regular reporting tasks are incorporated into the task lists to be controlled by SAP FCc.  Sometimes SAP FCc is leveraged to collect and document certain control activities as well. ► SAP FCc is designed to support Closing – however it can also leverage far more tasks in the Finance Department (and is not even limited to it). SAP S/4HANA Financial Closing cockpit*: Beyond Closing SAP S/4HANA 1709 SAP S/4HANA Financial Closing cockpit * Use cases described are valid with SAP FCc 2.0 as well.
  • 27.
    27PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 28.
    28PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Smart Business for Financial Close
  • 29.
    29PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Smart Business for Financial Close
  • 30.
    30PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ  SAP Smart Business for Financial Close 1.0 offers monitoring and analytics apps on top of SAP FCc. http://help.sap.com/ssb  Included in the standard license  Available with SAP ECC (requires SAP HANA) and SAP S/4HANA Finance (aka “Simple Finance add-on”) 1503 and 1605.  Is an optional component to SAP FCc; not intended to fully replace BW Content, no further investments from SAP side. SAP Smart Business for Financial Close SAP S/4HANA SAP Financial Closing cockpit
  • 31.
    31PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Lumira for Financial Close
  • 32.
    32PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Lumira for Financial Close
  • 33.
    33PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP BI content 7.07 https://help.sap.com/viewer/8283ab99b2f540c18afbe5cbb34501e3/7.07.20/en-US/b4912e8714ed4fb79d16ac876457d375.html
  • 34.
    34PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 35.
    35PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Deployment options SAP ECC SAP S/4HANA Finance (add-on) 1503, 1605 SAP S/4HANA Finance 1511, 1610 SAP S/4HANA Finance 1709* Fiori UX (WebDynpro) x SAP GUI x x x x SAP S/4HANA Financial Closing cockpit x SAP Smart Business x x SAP BW Content x x x** x** SAP Financial Closing cockpit 2.0 x x x * This is the current state of planning and may be changed by SAP at any time without notice. ** with restrictions
  • 36.
    36PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing Cockpit Analyze Execute Entity Close Management Monitor Plan
  • 37.
    37PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP S/4HANA Financial Closing cockpit
  • 38.
    38PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing Cockpit Entity Close Management Plan
  • 39.
    39PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Defining the Game Plan for the Entity Close (1)  The template contains:  all default tasks related to  Tasks are organized in hierarchies, e.g. by organizational units, responsibilities, and/or closing phases.  All tasks in the template are classified by closing type to support easy reuse Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Entity Close Local / Corporate Local Accountant
  • 40.
    40PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Defining the Game Plan for the Entity Close (2)  There are multiple types of tasks - Notes (pure manual steps) - Transactions - Programs with or w/o variant - Workflows - Jobs - Remote tasks - Tasks in other systems - Automation in the same system Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Entity Close Local / Corporate Local Accountant
  • 41.
    41PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Improved Task Maintenance for Organizational Units Three functions are available to maintain tasks in the Organizational hierarchy: - Copy task to all Organizational units - Replace in all Organizational units - Delete in all Organizational units
  • 42.
    42PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Support of different time zones
  • 43.
    43PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing Cockpit Execute Entity Close Management Plan
  • 44.
    44PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Preparing a Concrete Entity Close Cycle Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Entity Close Local / Corporate Local Accountant  The task list contains all tasks related to a concrete close cycle and the absolute schedule for the tasks.  The task list is generated from the template and adjusted according to the concrete closing cycle of the subsidiary.  Generation of task lists can even be organized under corporate responsibility to ensure a harmonized closing process across subsidiaries.
  • 45.
    45PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Executing and Documenting the Entity Close (1)  The task list can be accessed and processed by all stakeholders, either using SAP GUI or via a Web application.  Tasks can be executed online or scheduled for batch processing.  Task dependencies are taken into account, e.g. a task will not be started prior to its predecessors being finished. Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Entity Close Local / Corporate Local Accountant
  • 46.
    46PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Executing and Documenting the Entity Close (2)  The system provides detailed status information on each task.  It provides links to all system-created documentation (job logs, spool lists, application logs).  Users can add additional external documentation to tasks. Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Close Local / Corporate Local Accountant
  • 47.
    47PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Task-Schedule/Execution from Tasklist Web UI
  • 48.
    48PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing Cockpit Execute Entity Close Management Monitor Plan
  • 49.
    49PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Monitoring the Entity Close Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Close Local / Corporate Local Accountant  The status and progress of the entity close can be displayed as SAP NetWeaver BW queries that provide real-time access to the close figures or in the SAP Fiori Overview page (planned).  This enables corporate managers as well as managers of the subsidiaries to monitor the status of the closing process on their levels of responsibilities.
  • 50.
    50PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ BI Reporting – Closing Status Overview Provides an overview of the closing status of each task list
  • 51.
    51PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ BI Reporting – Closing Schedule Overview Provides an overview of each task’s schedule
  • 52.
    52PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP S/4HANA Financial Closing Cockpit Analyze Execute Entity Close Management Monitor Plan
  • 53.
    53PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Analyzing and Continually Improving the Entity Close Gain insightOptimize Prepare Entity Close * GL Submit to Corporate Close Assets CostsCorporate Accounting Local Accountant Execute Entity Close Tasks Monitor and Analyze Define Global Plan for Close Local / Corporate Local Accountant  The actual duration of the tasks in a single close can be compared with the planned duration using an SAP NetWeaver BW query or SAP Fiori (Planned).  This enables the user to improve the template based on clear insights for the next closing cycle.
  • 54.
    54PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ BI Reporting – Closing Schedule Analysis Analyses the tasks’ completion status
  • 55.
    55PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ BI Reporting – Closing Schedule Analysis (Cross Period) Provides an overview of the cross period schedule analysis of each task
  • 56.
    56PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Closing Cockpit with SAP S/4HANA SAP ECC Closing Cockpit  Close governance  Efficiency  Insight  Templates / task lists for standardized closing  UI for close management  Automation via jobs, WF  Monitoring of status and execution in SAP GUI Design Value
  • 57.
    57PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Financial Closing cockpit versus the closing cockpit functionality (CC) included in the SAP ERP license Stronger Governance Increased Efficiency Better Insight  Attachments per task in templates and task lists  Extended authorization (e.g. on task, org unit)  Multiple processors per task, HR org support  Central storage of logs  Comprehensive audit trail  Internal controls  Extended dependencies  Extended transports  Easy template definition  Filtering, mass changes  Factory calendars  Flexible notifications  Event-driven execution  Remote task execution  Integration to SAP CPS  Jobs of other schedulers  Access to WF monitor  Extensibility (e.g. variables)  Smart Business Cockpit*  Web user interface  Improved user experience (e.g. ready to execute)  Profiles for pre-selection within a task list  GANTT chart  Time zone support  Real-time BW queries for monitoring / analysis  Insight across multiple entities / close cycles  Templates / task lists for standardized closing CCin ERP AdditonalCapabilitiesof FinancialClosingcockpit  UI for close management  Automation via jobs, WF  Monitoring of status and execution in SAP GUI * requires SAP HANA
  • 58.
    58PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Closing Cockpit with SAP S/4HANA SAP ECC Closing Cockpit SAP S/4HANA Closing Cockpit
  • 59.
    59PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Customers who use the Closing Cockpit in ECC can continue to use the Closing Cockpit in SAP S/4HANA. NOTE: 2332547 - S4TWL - Closing Cockpit with S/4HANA OP The functionality of the standard Closing cockpit (without license) is available, but defined as "not the target architecture" in SAP S/4HANA 1511, 1610 or subsequent releases. See SAP note 2269324 – Compatibility Scope Matrix for SAP S/4HANA, on- premise edition. Thus transaction codes CLOCO, CLOCOC and CLOCOS are supported but are part of compatibility scope in S/4HANA OP. The Business Functions FIN_ACC_LOCAL_CLOSE, FIN_ACC_LOCAL_CLOSE_2, FIN_ACC_LOCAL_CLOSE_3 (requiring a license for SAP Financial Closing cockpit) are flagged as obsolete in S/4HANA OP. If any of the Business Functions listed above are active, consider to use the Add-On Financials Closing Cockpit 2.0 instead. https://launchpad.support.sap.com/#/notes/2332547 Closing Cockpit with SAP S/4HANA: Detail SAP S/4HANA Closing Cockpit
  • 60.
    60PUBLIC© 2017 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda SAP Financial Closing cockpit (SAP FCc)  Overview  Status SAP S/4HANA Financial Closing cockpit  Roadmap  SAP S/4HANA 1709  Outlook into the Cloud Use cases  Central Close  SAP Shared Service Framework and SAP S/4HANA FCc  SAP Process Control and SAP S/4HANA FCc  Beyond Closing Analytics  SAP FCc Analytics with SAP Smart Business  SAP FCc Analytics with SAP Lumira  SAP BI Content Additional Information  Availability options  Key Capabilities (SAP FCc process)  Closing cockpit
  • 61.
    What do youthink? Contact: Dr. Christoph Ernst Senior Director Finance Solutions SAP SE +49 160 9081 9609 Christoph.Ernst@sap.com
  • 62.
    No part ofthis publication may be reproduced or transmitted in any form or for any purpose without the express permission of SAP SE or an SAP affiliate company. The information contained herein may be changed without prior notice. Some software products marketed by SAP SE and its distributors contain proprietary software components of other software vendors. National product specifications may vary. These materials are provided by SAP SE or an SAP affiliate company for informational purposes only, without representation or warranty of any kind, and SAP or its affiliated companies shall not be liable for errors or omissions with respect to the materials. The only warranties for SAP or SAP affiliate company products and services are those that are set forth in the express warranty statements accompanying such products and services, if any. Nothing herein should be construed as constituting an additional warranty. In particular, SAP SE or its affiliated companies have no obligation to pursue any course of business outlined in this document or any related presentation, or to develop or release any functionality mentioned therein. This document, or any related presentation, and SAP SE’s or its affiliated companies’ strategy and possible future developments, products, and/or platform directions and functionality are all subject to change and may be changed by SAP SE or its affiliated companies at any time for any reason without notice. The information in this document is not a commitment, promise, or legal obligation to deliver any material, code, or functionality. All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, and they should not be relied upon in making purchasing decisions. SAP and other SAP products and services mentioned herein as well as their respective logos are trademarks or registered trademarks of SAP SE (or an SAP affiliate company) in Germany and other countries. All other product and service names mentioned are the trademarks of their respective companies. See http://global.sap.com/corporate-en/legal/copyright/index.epx for additional trademark information and notices. © 2017 SAP SE or an SAP affiliate company. All rights reserved.
