Building Information Modelling (BIM)
Leeds Arena – Case Study

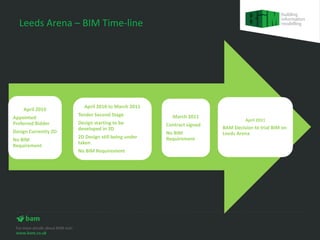

Leeds Arena – BIM Time-line




                        April 2010 to March 2011
    April 2010
                      Tender Second Stage             March 2011
Appointed                                                                      April 2011
Preferred Bidder      Design starting to be         Contract signed
                      developed in 3D                                 BAM Decision to trial BIM on
Design Currently 2D                                 No BIM            Leeds Arena
                      2D Design still being under   Requirement
No BIM
                      taken
Requirement
                      No BIM Requirement

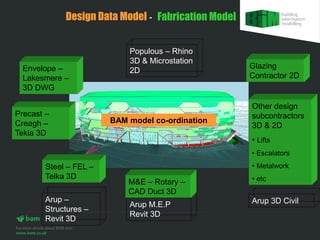

Design Data Model - Fabrication Model


                            Populous – Rhino
                            3D & Microstation
  Envelope –                                         Glazing
                            2D
  Lakesmere –                                        Contractor 2D
  3D DWG

                                                     Other design
Precast –                                            subcontractors
Creagh –                BAM model co-ordination
                                                     3D & 2D
Tekla 3D
                                                     • Lifts
                                                     • Escalators
        Steel – FEL –                                • Metalwork
        Telka 3D                                     • etc
                            M&E – Rotary –
                            CAD Duct 3D
        Arup –                                       Arup 3D Civil
                            Arup M.E.P
        Structures –
                            Revit 3D
        Revit 3D

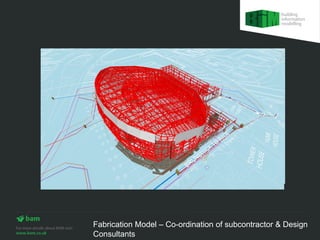

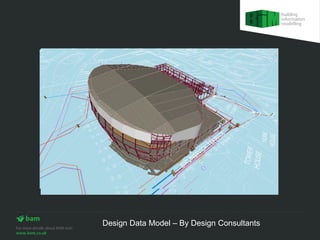

Design Data Model – By Design Consultants
Fabrication Model – Co-ordination of subcontractor & Design
Consultants

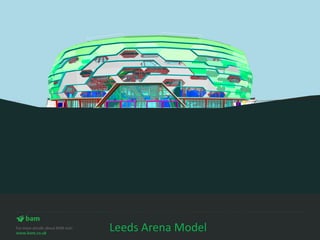

Leeds Arena Model

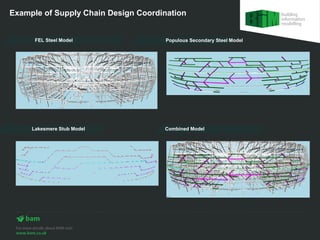

Example of Supply Chain Design Coordination


      FEL Steel Model                Populous Secondary Steel Model




     Lakesmere Stub Model            Combined Model

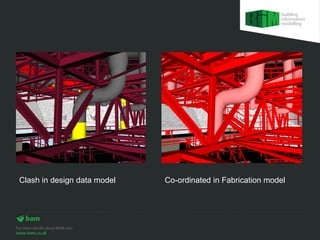

Clash in design data model   Co-ordinated in Fabrication model

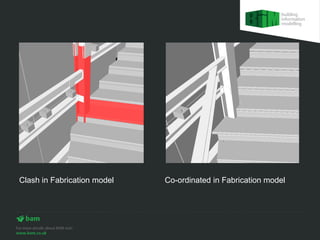

Clash in Fabrication model   Co-ordinated in Fabrication model

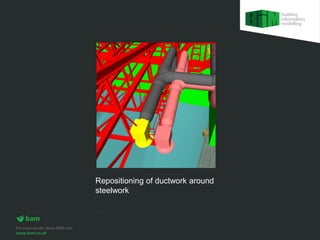

Repositioning of ductwork around
steelwork

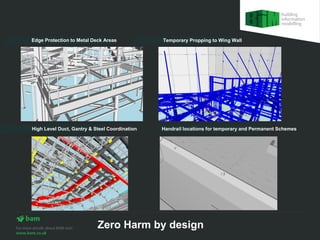

Edge Protection to Metal Deck Areas            Temporary Propping to Wing Wall




High Level Duct, Gantry & Steel Coordination   Handrail locations for temporary and Permanent Schemes




                           Zero Harm by design
Building Information Modelling (BIM)
Planning

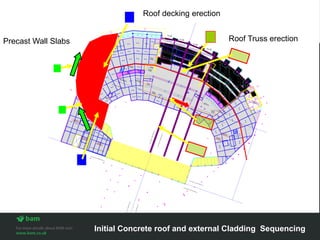

Roof decking erection


Precast Wall Slabs                                       Roof Truss erection




                     Initial Concrete roof and external Cladding Sequencing

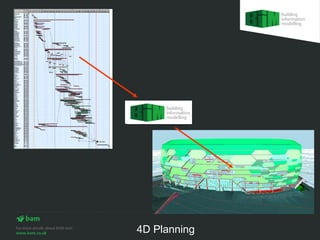

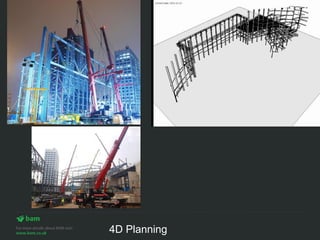

4D Planning
Steel   Precast




                  Steel


                                           Precast


                                           Steel




Logistics;- Precast and Structural Steel
4D Planning

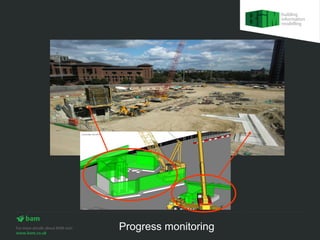

Progress monitoring

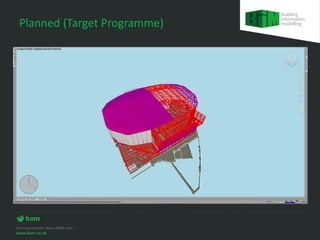

Planned (Target Programme)

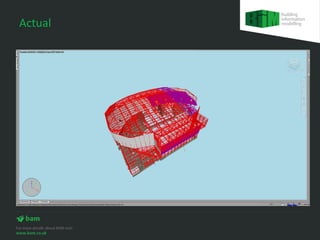

Actual

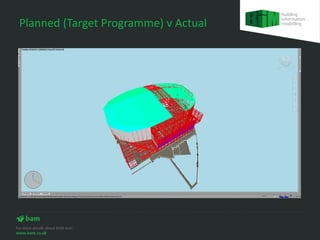

Planned (Target Programme) v Actual

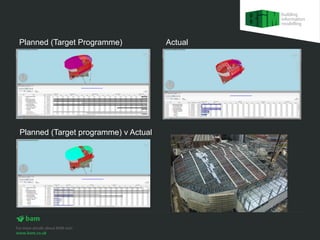

Planned (Target Programme)            Actual




Planned (Target programme) v Actual

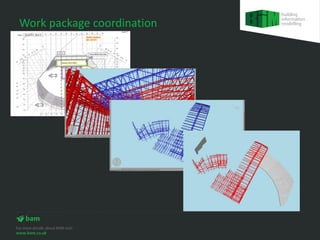

Work package coordination

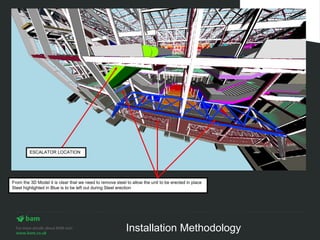

ESCALATOR LOCATION




From the 3D Model it is clear that we need to remove steel to allow the unit to be erected in place
Steel highlighted in Blue is to be left out during Steel erection




                                                           Installation Methodology

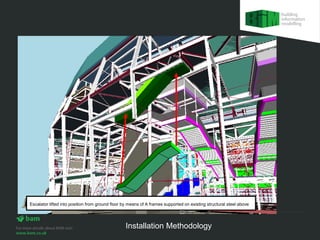

Escalator lifted into position from ground floor by means of A frames supported on existing structural steel above




                                                 Installation Methodology
Building Information Modelling (BIM)
Quantities

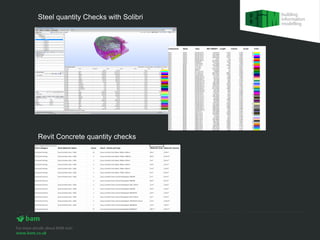

Steel quantity Checks with Solibri




Revit Concrete quantity checks
Building Information Modelling (BIM)
What next
Efficient Cost Planning & Procurement

• Quick measures from models
• Cost plans
• Direct take offs

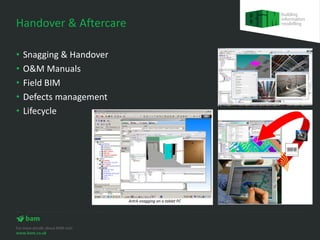

Handover & Aftercare

•   Snagging & Handover
•   O&M Manuals
•   Field BIM
•   Defects management
•   Lifecycle
Richard beaumont bam
