A PRESENTATION BY BUSINESS MANAGEMENT
AND ENTREPRENEURSHIP STUDENTS
BME GROUP 1, GROUP “A”
COURSE TITLE: PROJECT 1 (PRO 1)
LEARNING OUTCOME 4: PROJECT PLAN
FACILITATOR: MR. VICTOR OGUNSOLA
TEAM MEMBERS
 Obu Sandra Ndika
 Ibiang Ebri Williams
 Ojah Arikpo Alfred
 Okoi Obasesam David
We are BLOSSOM
EVENT PLANNERS
INTRODUCTION
The key to a successful project is in the planning. Creating a project
plan is the first thing ‘‘Blossom event planners’’ do when
undertaking any kind of project.
PROJECT PLAN
A project plan is a living document that provides direction for a project.
OUR PROJECT WILL BE ANSWERING THE FOLLOWING
QUESTIONS
 What?………………. A birthday party.
 Why?…………………To plan a successful birthday event.
Who?………………… Allocation of task / Team members responsibilities
How?.................... Work breakdown structure(WBS).
When?………………….20th of June - 30th of July, 2015.
Where?………………… Axari hotel, Calabar.
 How much?…………. …N 2,250,650
THE PROJECT WE HAVE AT HAND
To plan a birthday party for Emerald Ayade, the first daughter of professor
Benjamin Ayade. The governor of Cross River state.

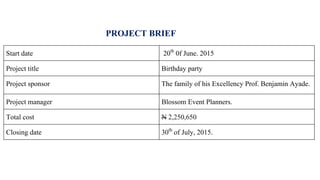

PROJECT BRIEF
Start date 20th 0f June. 2015
Project title Birthday party
Project sponsor The family of his Excellency Prof. Benjamin Ayade.
Project manager Blossom Event Planners.
Total cost N 2,250,650
Closing date 30th of July, 2015.
PROJECT ROLES AND RESPONSIBILITIES
PROJECT MANAGER……………………………..Sandra Ndika Obu
PROJECT ADMINISTRATOR…………………..Arikpo Alfred Ojah
SENIOR CONSULTANT……………………………Ebri William Ibiang
SYSTEM ADMINISTRATOR……………………..Obasesam D. Okoi
PROJECT VISION
Our vision for this project is to accomplished a successful top rated
birthday party for miss Emerald Ayade on the 30th July.
SCHEDULING
Search of venue 20-27 of June, 2015.
Printing of invitation cards 28 of June – 4th of July.
MC and DJ 5th - 8th July.
Comedian 9th – 15th July.
Souvenirs 16th – 22th July.
Food, drinks and decoration 29th – 30 July
Final day of execution 30th of July, 2015
OBJECTIVES OF OUR PROJECT
Preparing for the party with extra time is the best way to guarantee the birthday
success.
Pre-planning: A month before the party
Step 1. Budget
Step 2. Choose the date
Step 3. Pick the venue
Step 4. Making of a guest list
Step 5. Sending of invitations
….CONT’D
Planning the Details: 3 weeks before the party
Food:
We intend to use a buffet which is easiest method of serving food.
Decorations:
This will be done by Benbas project consult.
Entertainment and games
Favours
PROJECT SCOPE STATEMENT
Invitation of guests
 Playlist compiled
 Food and drinks should be made available.
 No alcoholic beverages are to be served.
 Party will end by 10 pm, same day.
….CONT’D
Technical Requirements
 Guest car park would be available.
 Noise level should not disturb neighbours.
 Music must alternate between slow and fast songs.
 Enough food for 100 guests.
KEY DELIVERABLES
 Project definition document
Project budget
Project schedule
 Status report
Lesson learnt log
Risk log document
 Final acceptance document
PROJECT BUDGET
ITEMS UNIT PRICE (N) QUANTITY TOTAL PRICE (N)
VENUE A Hall 1 Large Hall 150,000
PRINTING OF INVITATION CARDS 300 100 30,000
DECORATION MATERIALS
Materials 150 per yard 300 4,5000
Thumbtacks 500 2 1,000
Ribbons 250 5 1,250
Balloons 10 100 1,000
Table Toppers 150 50 7,500
Crystal Garlands & Strands 1,500 3 4,500
Flowers 100 50 5,000
Materials (lining) 1,5000 3 4,500
Chair Bows 50 50 2,500
Pendants & Ornaments 1,500 3 4,500
Total 36,250
….CONT’D
ITEMS UNIT PRICE (N ) QUANTITY TOTAL PRICE (N )
Five (5) Steps Cake. 30,000 1 30,000
FOOD
A bag of rice (50kg) 11,000 1 11,000
Big tin of gino tomatoes 800 2 1,600
Fresh tomatoes 1,000 1 basket 1,000
Meat (full cow) 80,000 1 80,000
Chicken 1,500 20 kg 30,000
Spices 1,500 Varieties 1,500
Oil 3,000 2 Cans of Turkey oil 6,000
TOTAL 131,100
….CONT’
ITEMS UNIT PRICE (N) QUANTITY TOTAL PRICE(N)
DRINKS
Cocktail wine 5,000 3 cartons 15,000
Varieties of fruit juice 2,000 3 cartons 6,000
Guinness malt 1,400 2 crates 2,800
Cans of minerals 500 10 cartons 5,000
Eva water (75cl) 1,200 7 cartons 8,400
Table 30 70 2,100
Hundred chairs 20 200 4,000
MC & DG 300,000 300,000
Souvenirs 300,000 Different gifts 300,000
Money for Blossom
event planners
(workmanship)
1,200,000 1,200,000
TOTAL N 2,250,650
IDENTIFYING DEPENDENCIES
 Dependencies are the relationships of the preceding tasks to
the succeeding tasks.
Finish-to-start:
The items that a milestone depends on, must be ready before the
next milestone can start.
F
S
Key milestones, Activity Planning (WBS) and
Responsibilities
STAKEHOLDERS INVOLVED
The celebrant
 The celebrant family
 Guests
 Blossom Event Planners
 Axari Hotel
RESOURCES
Human resources
Money (N 2,250,650)
 Materials resources
TIME SCALES
20th of June – 30th of July.
FINAL DEADLINE
30th July, 2015.
MARKETING RESEARCH
Primary market research
MARKETING PLAN
To market our event-planning business;
We render quality services at affordable prices.
 Build and maintain good relationship with our customers.
USP (Unique Selling Preposition)
BUSINESS ENVIRONMENT
 Calabar, being our business environment is peaceful.
ISSUES INVOLVED
 Theft.
 Power interruption.
 Ineffective communication.
 Poor weather condition.
 Poor time management on the invitees.
RISK INVOLVED
 Injuries through sharp objects during decoration
 Guns held by the security operatives
 Unclear roles and responsibilities.

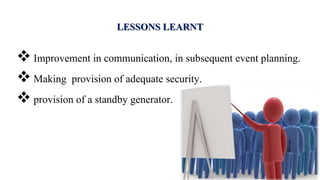

LESSONS LEARNT
 Improvement in communication, in subsequent event planning.
 Making provision of adequate security.
 provision of a standby generator.
Conclusion
A project is successful when the needs of the stakeholders have
been met. Hence, all modalities have been put in place to
achieve this project aims.
PROJECT BRIEF (1)
PROJECT BRIEF (1)

PROJECT BRIEF (1)

  • 2.
    A PRESENTATION BYBUSINESS MANAGEMENT AND ENTREPRENEURSHIP STUDENTS BME GROUP 1, GROUP “A” COURSE TITLE: PROJECT 1 (PRO 1) LEARNING OUTCOME 4: PROJECT PLAN FACILITATOR: MR. VICTOR OGUNSOLA
  • 3.
    TEAM MEMBERS  ObuSandra Ndika  Ibiang Ebri Williams  Ojah Arikpo Alfred  Okoi Obasesam David
  • 4.
  • 5.
    INTRODUCTION The key toa successful project is in the planning. Creating a project plan is the first thing ‘‘Blossom event planners’’ do when undertaking any kind of project.
  • 6.
    PROJECT PLAN A projectplan is a living document that provides direction for a project.
  • 7.
    OUR PROJECT WILLBE ANSWERING THE FOLLOWING QUESTIONS  What?………………. A birthday party.  Why?…………………To plan a successful birthday event. Who?………………… Allocation of task / Team members responsibilities How?.................... Work breakdown structure(WBS). When?………………….20th of June - 30th of July, 2015. Where?………………… Axari hotel, Calabar.  How much?…………. …N 2,250,650
  • 8.
    THE PROJECT WEHAVE AT HAND To plan a birthday party for Emerald Ayade, the first daughter of professor Benjamin Ayade. The governor of Cross River state.
  • 9.
    PROJECT BRIEF Start date20th 0f June. 2015 Project title Birthday party Project sponsor The family of his Excellency Prof. Benjamin Ayade. Project manager Blossom Event Planners. Total cost N 2,250,650 Closing date 30th of July, 2015.
  • 10.
    PROJECT ROLES ANDRESPONSIBILITIES PROJECT MANAGER……………………………..Sandra Ndika Obu PROJECT ADMINISTRATOR…………………..Arikpo Alfred Ojah SENIOR CONSULTANT……………………………Ebri William Ibiang SYSTEM ADMINISTRATOR……………………..Obasesam D. Okoi
  • 11.
    PROJECT VISION Our visionfor this project is to accomplished a successful top rated birthday party for miss Emerald Ayade on the 30th July.
  • 12.
    SCHEDULING Search of venue20-27 of June, 2015. Printing of invitation cards 28 of June – 4th of July. MC and DJ 5th - 8th July. Comedian 9th – 15th July. Souvenirs 16th – 22th July. Food, drinks and decoration 29th – 30 July Final day of execution 30th of July, 2015
  • 13.
    OBJECTIVES OF OURPROJECT Preparing for the party with extra time is the best way to guarantee the birthday success. Pre-planning: A month before the party Step 1. Budget Step 2. Choose the date Step 3. Pick the venue Step 4. Making of a guest list Step 5. Sending of invitations
  • 14.
    ….CONT’D Planning the Details:3 weeks before the party Food: We intend to use a buffet which is easiest method of serving food. Decorations: This will be done by Benbas project consult. Entertainment and games Favours
  • 15.
    PROJECT SCOPE STATEMENT Invitationof guests  Playlist compiled  Food and drinks should be made available.  No alcoholic beverages are to be served.  Party will end by 10 pm, same day.
  • 16.
    ….CONT’D Technical Requirements  Guestcar park would be available.  Noise level should not disturb neighbours.  Music must alternate between slow and fast songs.  Enough food for 100 guests.
  • 17.
    KEY DELIVERABLES  Projectdefinition document Project budget Project schedule  Status report Lesson learnt log Risk log document  Final acceptance document
  • 18.
    PROJECT BUDGET ITEMS UNITPRICE (N) QUANTITY TOTAL PRICE (N) VENUE A Hall 1 Large Hall 150,000 PRINTING OF INVITATION CARDS 300 100 30,000 DECORATION MATERIALS Materials 150 per yard 300 4,5000 Thumbtacks 500 2 1,000 Ribbons 250 5 1,250 Balloons 10 100 1,000 Table Toppers 150 50 7,500 Crystal Garlands & Strands 1,500 3 4,500 Flowers 100 50 5,000 Materials (lining) 1,5000 3 4,500 Chair Bows 50 50 2,500 Pendants & Ornaments 1,500 3 4,500 Total 36,250
  • 19.
    ….CONT’D ITEMS UNIT PRICE(N ) QUANTITY TOTAL PRICE (N ) Five (5) Steps Cake. 30,000 1 30,000 FOOD A bag of rice (50kg) 11,000 1 11,000 Big tin of gino tomatoes 800 2 1,600 Fresh tomatoes 1,000 1 basket 1,000 Meat (full cow) 80,000 1 80,000 Chicken 1,500 20 kg 30,000 Spices 1,500 Varieties 1,500 Oil 3,000 2 Cans of Turkey oil 6,000 TOTAL 131,100
  • 20.
    ….CONT’ ITEMS UNIT PRICE(N) QUANTITY TOTAL PRICE(N) DRINKS Cocktail wine 5,000 3 cartons 15,000 Varieties of fruit juice 2,000 3 cartons 6,000 Guinness malt 1,400 2 crates 2,800 Cans of minerals 500 10 cartons 5,000 Eva water (75cl) 1,200 7 cartons 8,400 Table 30 70 2,100 Hundred chairs 20 200 4,000 MC & DG 300,000 300,000 Souvenirs 300,000 Different gifts 300,000 Money for Blossom event planners (workmanship) 1,200,000 1,200,000 TOTAL N 2,250,650
  • 21.
    IDENTIFYING DEPENDENCIES  Dependenciesare the relationships of the preceding tasks to the succeeding tasks. Finish-to-start: The items that a milestone depends on, must be ready before the next milestone can start. F S
  • 22.
    Key milestones, ActivityPlanning (WBS) and Responsibilities
  • 23.
    STAKEHOLDERS INVOLVED The celebrant The celebrant family  Guests  Blossom Event Planners  Axari Hotel
  • 24.
    RESOURCES Human resources Money (N2,250,650)  Materials resources
  • 25.
    TIME SCALES 20th ofJune – 30th of July.
  • 26.
  • 27.
  • 28.
    MARKETING PLAN To marketour event-planning business; We render quality services at affordable prices.  Build and maintain good relationship with our customers. USP (Unique Selling Preposition)
  • 29.
    BUSINESS ENVIRONMENT  Calabar,being our business environment is peaceful.
  • 30.
    ISSUES INVOLVED  Theft. Power interruption.  Ineffective communication.  Poor weather condition.  Poor time management on the invitees.
  • 31.
    RISK INVOLVED  Injuriesthrough sharp objects during decoration  Guns held by the security operatives  Unclear roles and responsibilities.
  • 32.
    LESSONS LEARNT  Improvementin communication, in subsequent event planning.  Making provision of adequate security.  provision of a standby generator.
  • 33.
    Conclusion A project issuccessful when the needs of the stakeholders have been met. Hence, all modalities have been put in place to achieve this project aims.
