Investor           November 2011
               William J. Biggar
PRESENTATION      President & CEO
Forward Looking
STATEMENTS
Certain information included in this presentation, including any information as to our future production,
exploration, financial or operating performance and other statements that express management's
expectations or estimates of future performance, constitute „forward-looking statements‟ within the meaning
of the „safe harbor‟ provisions of the United States Private Securities Litigation Reform Act of 1995 and
Canadian securities laws. The words „expect‟, „believe‟, „will‟, „intend‟, „estimate‟ and similar expressions
identify forward-looking statements. Forward-looking statements, including future-oriented financial
information, are necessarily based upon a number of estimates and assumptions that, while considered
reasonable by management, are inherently subject to significant business, economic and competitive
uncertainties, risks and contingencies, including the possibility that operations at the Lac des Iles and Sleeping
Giant mines may not proceed as planned, that other properties may not be successfully developed, and that
metal prices, foreign exchange assumptions and operating costs may differ from management‟s
expectations. The Company cautions the reader that such forward-looking statements involve known and
unknown risks, uncertainties and other factors that may cause the actual financial results, performance or
achievements of North American Palladium to be materially different from the Company‟s estimated future
results, performance or achievements expressed or implied by those forward-looking statements and that the
forward-looking statements are not guarantees of future performance. For more details on these estimates,
risks, assumptions and factors, see the Company‟s most recent Form 40-F/Annual Information Form on file with
the U.S. Securities and Exchange Commission and Canadian provincial securities regulatory authorities. The
Company disclaims any obligation to update or revise any forward-looking statements, whether as a result of
new information, events or otherwise, except as expressly required by law. Readers are cautioned not to put
undue reliance on these forward-looking statements.

All dollar amounts in Canadian currency unless otherwise stated, all references to production refer to payable
production, and all reference to tonnes refer to metric tonnes.

U.S. investors are encouraged to refer to the “Cautionary Note to U.S. Investors Concerning Estimates of
Measured, Indicated and Inferred Resources” in the appendix.
                                                                                                                1
Investment Case
FOR NAP

• Growth-oriented precious metals producer in mining-friendly
  jurisdictions:
   • LAC DES ILES, one of only two primary palladium mines in the world,
     transitioning into a long-life, low-cost operation

   • GOLD DIVISION provides foundation for growth

• Robust pipeline of projects to increase palladium and gold production

• Significant commitment to palladium and gold exploration

• Experienced senior management and operating teams

• Strong balance sheet to fund development programs

                                                                           2

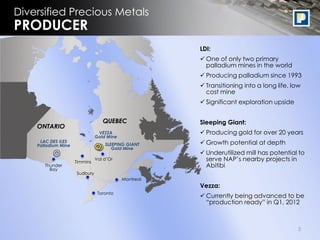

Diversified Precious Metals
PRODUCER
                                                      LDI:
                                                       One of only two primary
                                                        palladium mines in the world
                                                       Producing palladium since 1993
                                                       Transitioning into a long life, low
                                                        cost mine
                                                       Significant exploration upside

                                  QUEBEC              Sleeping Giant:
    ONTARIO
                                VEZZA                  Producing gold for over 20 years
                               Gold Mine
     LAC DES ILES
    Palladium Mine                 SLEEPING GIANT      Growth potential at depth
                                      Gold Mine
                                                       Underutilized mill has potential to
                     Timmins
                               Val d‟Or                 serve NAP‟s nearby projects in
       Thunder                                          Abitibi
         Bay
                     Sudbury
                                           Montreal
                                                      Vezza:
                                Toronto
                                                       Currently being advanced to be
                                                        “production ready” in Q1, 2012

                                                                                          3

Market Statistics:
A VERY LIQUID STOCK

            STOCK SYMBOLS             NYSE Amex: PAL         $9.00
                                      TSX: PDL               $8.00
                                                             $7.00
 MARKET CAPITALIZATION                US $567 M              $6.00
                                                             $5.00
                  SHARE PRICE         US $3.50
                                                             $4.00
                                                             $3.00
    SHARES OUTSTANDING                162.4 M
                                                             $2.00
        52-WEEK HIGH/LOW              US $7.92/$2.10         $1.00
                                                             $0.00
        3-MONTH AVERAGE               NYSE Amex: 2,137,952
          TRADING VOLUME              TSX: 358,997

Information as at Nov. 4, 2011, Thomson One.
                                                                     4
Market Statistics:
STRONG STREET FOLLOWING

ANALYST COVERAGE     RBC Capital Markets
                     Leon Esterhuizen
Cormark Securities
Rajiv Chail          Scotia Capital
Credit Suisse        Leily Omoumi
Nathan Littlewood
                     Stifel Nicolaus
GMP Securities       George Topping
Andrew Mikitchook
Haywood Securities
Chris Thompson       TOP 5 INSTITUTIONAL INVESTORS
Macquarie            1.   RBC Global Asset Management
Daniel Greenspan
Merrill Lynch        2.   T. Rowe Price Associates
Michael Parkin
                     3.   Mackenzie Financial Corporation
Octagon Capital
Annie Zhang          4.   Chilton Investment Company
Raymond James        5.   Soros Fund Management
Bart Jaworski

                                                            5
Financial
STRENGTH

  • $95.7 M in working capital (including $37.5 M in cash) as at Sept. 30, 2011

  • $60 M operating line

  • $72 M term debt financing closed on Oct. 4, 2011

     – Increasing Sept. 30, 2011 pro-forma cash to $110 M

                                                                                  6
Investment Case for
      PALLADIUM

                      7

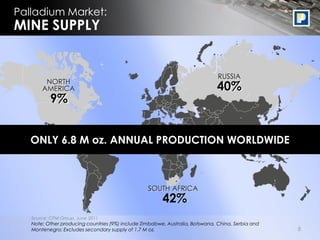

Palladium Market:
MINE SUPPLY

                                                                               RUSSIA
        NORTH
       AMERICA                                                                40%
          9%

   ONLY 6.8 M oz. ANNUAL PRODUCTION WORLDWIDE

                                                  SOUTH AFRICA
                                                        42%
   Source: CPM Group, June 2011
   Note: Other producing countries (9%) include Zimbabwe, Australia, Botswana, China, Serbia and
   Montenegro; Excludes secondary supply of 1.7 M oz.                                              8
Palladium Market:

SUPPLY

          Constrained Mine Supply From Major Producers
 (000’s ounces)

 3,500
                                       Russia       South Africa
 3,000
 2,500
 2,000
 1,500
 1,000
   500
      0
                2006            2007     2008      2009            2010

 • Russian state stockpiles believed to be at or near exhaustion

 Source: CPM Group, June 2011
                                                                          9
Palladium Market:
DEMAND

     2010 Fabrication Demand: 7.5 M oz.

             Refining          Dental
  Automotive    6%              10%     Other
     58%                                3%

                                           Jewellery
                                            7%

                                                Electronics
                                                 16%

Source: CPM Group, June 2011
                                                              10
Palladium Market:

DEMAND
        Global Light Vehicle Production – 5 Year Forecast

       (000‟s)
                                                                         97M    100M
      100,000                                                 92M
                                                   88M                                 Other1
       90,000                          84M
       80,000     72M        75M
                                                                                       Europe
       70,000
       60,000
                                                                                       North
       50,000                                                                          America
       40,000
       30,000                                                                          BRIC
       20,000                                                                          Economies2
       10,000
            0
                  2010       2011       2012       2013       2014       2015   2016
                 (Actual)

       Source: IHS Global Insight Automotive, June 2011
       1. Other includes: Japan, Korea, Middle East and Africa
       2. BRIC Economies include: Greater China, South America and South Asia

 • Majority of demand derived from automobile sector for autocatalysts
 • Strongest growth in regions outside of North America, Europe and Japan
                                                                                                    11
Palladium Market:
DEMAND

       Adoption of Stricter Emission Control Standards
                           2005        2006      2007        2008      2009        2010    2011    2012      2013   2014      2015
  Europe                   Euro IV                                     Euro V                                       Euro VI

             Beijing       Euro III              Euro IV                                           Euro V
  China
           Nationwide      Euro II               Euro III                       Euro IV

           Select Cities   Euro III                                             Euro IV
   India
           Nationwide      Euro II                                              Euro III

  Russia                   Euro I      Euro II              Euro III            Euro IV                             Euro V

   USA                      Tier 2 and LEV II

  Brazil                   Prconve 3             Prconve 4             Prconve 5                            Prconve 6

  Japan                     Japan 05                                                              Source: CPM Group, June 2011

 • Emerging economies have adopted emission control standards that mandate the
   use of catalytic converters
 • Advancing to a higher level of emission controls results in higher PGM loadings in
   the catalytic converter
 • Tightening emission control regulations for heavy-duty trucks
                                                                                                                                     12
Use of Palladium in
CATALYTIC CONVERTERS
Gasoline Engines                                                     Hybrids & Other New Forms
• Use +90% palladium (of total required                              • Neutral impact on PGM use
  PGM content)                                                       • Gasoline hybrids tend to use as much
                                                                       palladium as normal gasoline engines

Diesel Engines                                                       • Currently account for only 1% of global
                                                                       cars sales1
• Historically used platinum due to
  technical requirements                                             • Forecasted to be 14% of overall market
                                                                       by 20202
• Currently use 25% palladium, with scope
  to increase to 50% due to advent of low
  sulphur diesel fuel                                                Electric
                                                                     • No requirement for catalytic converters
                                                                     • Challenged by lack of infrastructure to
                                                                       recharge, high costs, long charging
                                                                       periods and short driving range
                                                                     • Forecasted to account for only 2% of
                                                                       global car sales by 20202

 1. CPM Group, June 2010
 2. Stefan Bratzel, director of the Centre of Automotive Management in Germany;
    as reported in Mitsui Global Precious Metals “Pole Position” Report, June 2010                               13
Palladium Market:
DEMAND

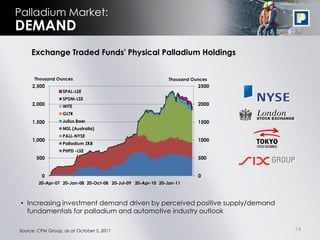

     Exchange Traded Funds' Physical Palladium Holdings

      Thousand Ounces                                         Thousand Ounces
     2,500                                                               2500
                  SPAL-LSE
                  SPDM-LSE
     2,000        WITE                                                   2000
                  GLTR
     1,500        Julius Baer                                            1500
                  MSL (Australia)
                  PALL-NYSE
     1,000                                                               1000
                  Palladium ZKB
                  PHPD -LSE
       500                                                               500

         0                                                               0
        20-Apr-07 20-Jan-08 20-Oct-08 20-Jul-09 20-Apr-10 20-Jan-11

 • Increasing investment demand driven by perceived positive supply/demand
   fundamentals for palladium and automotive industry outlook

Source: CPM Group, as at October 5, 2011                                        14

Palladium Market:
INCREASING PRICE

 Recent performance of Palladium (US$/oz)                  Average Annual Price Forecast (US$/oz)

$900.00                                                                               2011        2012
$800.00                                                     BNP Paribas               $860        $810
$700.00
                                                            CPM Group                 $849        $908
$600.00
                                                            JP Morgan                 $838        $938
$500.00
$400.00                                                     Credit Suisse             $803        $950
$300.00                                                     Barclays                  $820        $860
$200.00                                                     UBS                       $800        $825
$100.00                                                     RBC Capital Markets       $780        $850
  $0.00
    1/2/2008       1/2/2009       1/2/2010      1/2/2011   Historic High: US $1,090 (2001)
                                                           Recent Price: US $651 (Nov. 4, 2011)
                                                           YTD Average Price: US$746

 Sources: Thomson One and available equity research.
                                                                                                         15
Palladium Operations
LAC DES ILES MINE

                   16

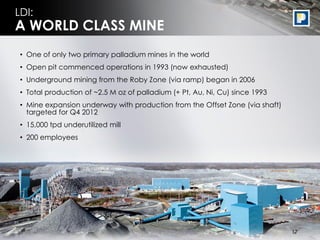

LDI:
A WORLD CLASS MINE
 • One of only two primary palladium mines in the world
 • Open pit commenced operations in 1993 (now exhausted)
 • Underground mining from the Roby Zone (via ramp) began in 2006
 • Total production of ~2.5 M oz of palladium (+ Pt, Au, Ni, Cu) since 1993
 • Mine expansion underway with production from the Offset Zone (via shaft)
   targeted for Q4 2012
 • 15,000 tpd underutilized mill
 • 200 employees

                                                                               17
                                                                              17

LDI:
OPERATING METRICS

                                                                                                                    2011
                                      Q1 2011             Q2 2011           Q3 2011               YTD
                                                                                                                  Forecast
 Payable Palladium                                                                                                145,000 -
                                        30,661             46,971            34,871            112,503
 Production (oz)                                                                                                   155,000
 Tonnes of Ore Mined                   332,523            428,692            477,923          1,239,138           1,460,000
 Avg. Head Grade
                                        3.9 g/t            5.0 g/t           3.5 g/t            4.1 g/t             4.2 g/t
 Milled
 Palladium Mill
                                        78.8%              83.2%              76.4%             79.7%                80%
 Recovery
 Cash Costs1 ($US/oz)                    $519               $335               $496              $436                $450

 1. Total cash costs per ounce is a non-IFRS measure. For reconciliation of historical total cash costs per ounce to production
    costs, please refer to the Company‟s financial statements. Cash costs per ounce are presented net of byproduct credits
    and can be materially affected by changes in byproduct metal prices, as well as the Canadian/US dollar exchange rate.         18
LDI:

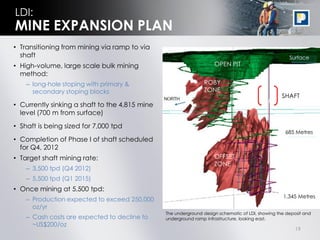

MINE EXPANSION PLAN
• Transitioning from mining via ramp to via
  shaft                                                                                               Surface
• High-volume, large scale bulk mining                               OPEN PIT
  method:
    – long-hole stoping with primary &                          ROBY
      secondary stoping blocks                                  ZONE
                                                                                                   SHAFT
• Currently sinking a shaft to the 4,815 mine
  level (700 m from surface)

• Shaft is being sized for 7,000 tpd
                                                                                                    685 Metres
• Completion of Phase I of shaft scheduled
  for Q4, 2012
• Target shaft mining rate:                                          OFFSET
                                                                     ZONE
    – 3,500 tpd (Q4 2012)
    – 5,500 tpd (Q1 2015)
• Once mining at 5,500 tpd:
                                                                                                   1,345 Metres
    – Production expected to exceed 250,000
      oz/yr
                                                The underground design schematic of LDI, showing the deposit and
    – Cash costs are expected to decline to     underground ramp infrastructure, looking east.
      ~US$200/oz
                                                                                                        19
LDI:

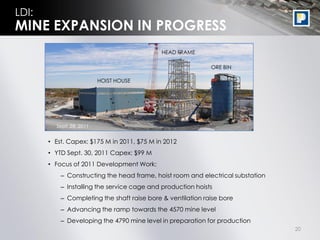

MINE EXPANSION IN PROGRESS
                                             HEAD FRAME

                                                             ORE BIN

                          HOIST HOUSE

         Sept. 28, 2011

       • Est. Capex: $175 M in 2011, $75 M in 2012
       • YTD Sept. 30, 2011 Capex: $99 M
       • Focus of 2011 Development Work:
           – Constructing the head frame, hoist room and electrical substation
           – Installing the service cage and production hoists
           – Completing the shaft raise bore & ventilation raise bore
           – Advancing the ramp towards the 4570 mine level
           – Developing the 4790 mine level in preparation for production
                                                                                 20
LDI Mine Expansion:
LOW EXECUTION RISK

• Over 17 years of mining experience at LDI with a solid track record of underground
  development

• Experienced 20-person development team on site overseeing all aspects of the
  expansion with the support of industry-leading contractors

• Brownfield expansion vs. greenfield project
    • Utilizes existing Roby Zone development platform
    • Underutilized mill and tailings facilities in place
    • No long lead items
    • No capex currency risk (all expenditures are in C$)

                                                                                       21

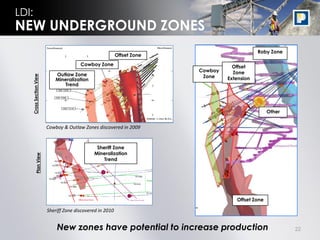

LDI:
NEW UNDERGROUND ZONES
                                                                                             Roby Zone
                                                          Offset Zone
                                       Cowboy Zone                                 Offset
                                                                        Cowboy     Zone
                           Outlaw Zone                                   Zone
   Cross Section View

                           Mineralization                                        Extension
                              Trend

                                                                                                  Other

                        Cowboy & Outlaw Zones discovered in 2009

                                              Sheriff Zone
                                             Mineralization
          Plan View

                                                 Trend

                                                                                    Offset Zone

                        Sheriff Zone discovered in 2010

                            New zones have potential to increase production                               22
LDI:
CONTINUING FOCUS ON EXPLORATION

Growing Through the Drill Bit

Significant 2011 Exploration Program*:
• Budget: $8.8M
• 32,000 m of drilling:
    – 25,000 m at LDI
    – 3,000 m at Legris Lake

    – 4,000 m at NAP‟s other nearby properties

    * Excludes 46,000 metres of expansion project drilling
                                                             23

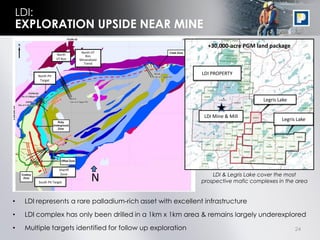

LDI:
EXPLORATION UPSIDE NEAR MINE
                                                               +30,000-acre PGM land package
                                 North VT
                    North          Rim
                    VT Rim      Mineralized
                                  Trend

        North Pit
                                                             LDI PROPERTY
         Target

                                                                                   Legris Lake

                                                              LDI Mine & Mill
                                                                                           Legris Lake

                      Sheriff
                                                                 LDI & Legris Lake cover the most
                       Zone

        South Pit Target
                                       N                     prospective mafic complexes in the area

•   LDI represents a rare palladium-rich asset with excellent infrastructure

•   LDI complex has only been drilled in a 1km x 1km area & remains largely underexplored
•   Multiple targets identified for follow up exploration                                        24
LDI Exploration Potential
INDEPENDENT REVIEW
• Independent exploration review of LDI property conducted by Revelation
  Geoscience, experts in PGE deposits
• Key findings:
   – “Globally, there are few available advanced           WE HAVE ONLY
     PGE exploration investment opportunities as       SCRATCHED THE SURFACE
     attractive as LDI (technical quality risk, PGE
     focus).”

   – “Exploration opportunities at LDI are highly
     ranked in comparison to most advanced PGE
     properties on a global basis. Low overall risk
     given existing infrastructure and permitting.
     Clear path to expanding production.”

   – “Several areas on the Mine Block Intrusion have
     immediate potential for expanding the resource
     base. Offset Zone south extension, Cowboy,
     Outlaw & Sheriff zones. Good historical link
     between exploration spend and resource quality
     and size. Encouraged to continue with
     aggressive exploration.”

                                                                           25
Gold
OPERATIONS

         26

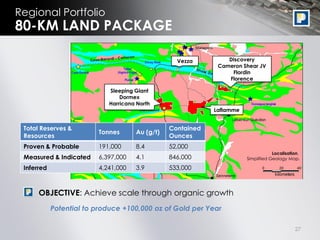

Regional Portfolio
80-KM LAND PACKAGE

                                                  Vezza         Discovery
                                                             Cameron Shear JV
                                                                 Flordin
                                                                Florence

                            Sleeping Giant
                                Dormex
                            Harricana North
                                                            Laflamme

 Total Reserves &                               Contained
                         Tonnes      Au (g/t)
 Resources                                      Ounces
 Proven & Probable       191,000     8.4        52,000
                                                                                   Localisation.
 Measured & Indicated    6,397,000   4.1        846,000                Simplified Geology Map.

 Inferred                4,241,000   3.9        533,000

      OBJECTIVE: Achieve scale through organic growth
            Potential to produce +100,000 oz of Gold per Year

                                                                                             27
Sleeping Giant
MINE

• 2011 transition year while development at depth is completed
• Operations and cost structure revised to focus on quality (grade) vs. quantity
  (tonnage) to improve profitability
• 2011 gold production guidance: 15,000 – 20,000 oz.
• 110 employees currently at mine & mill site
                                                                                   28

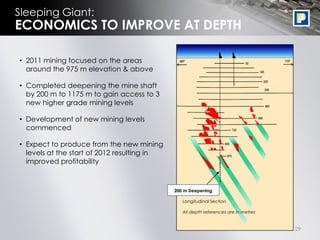

Sleeping Giant:
ECONOMICS TO IMPROVE AT DEPTH

• 2011 mining focused on the areas
  around the 975 m elevation & above

• Completed deepening the mine shaft
  by 200 m to 1175 m to gain access to 3
  new higher grade mining levels

• Development of new mining levels
  commenced

• Expect to produce from the new mining
  levels at the start of 2012 resulting in
  improved profitability

                                             200 m Deepening

                                                Longitudinal Section

                                                All depth references are in metres

                                                                                     29
Sleeping Giant:
UNDERUTILIZED CENTRAL MILL
Strategic Asset
• Ability to serve NAP‟s other gold projects
  in Abitibi region

• 900 tpd mill currently operating at
  ½ capacity

    – Future plans for expansion to1,250
      tpd or 1,750 tpd

• In 2011, the Company will spend ~$2 M
  on the expansion, which includes:
    – geotechnical tests
    – building & foundation designs
    – detailed engineering work
    – receiving the required construction
      permits
    – materials procurement, including
      refurbished rod mill & jaw crusher

                                               30
Vezza Gold Project
DEVELOPMENT

• 85 km by paved road to SG mill

• Advanced-stage project:

   – Extensive drilling (+100,000 m)

   – Hoist & 3-compartment shaft
   – 4 underground levels down to a depth of 741 m

   – Surface infrastructure in place                    Production Potential: 39,000 oz/yr
                                                        Mining Rate: 750 tpd
• 2011 exploration & development capex budget:
                                                        Mine Life: 9 years
  $32M

• YTD Sept. 30, 2011 capex: $21 M

• 40,000-tonne bulk sample to be processed at SG mill
  planned for Q4, 2011/Q1, 2012
• Being advanced to be “production ready” in Q1,
  2012

                                                                                     31

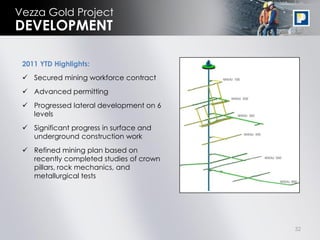

Vezza Gold Project
DEVELOPMENT

 2011 YTD Highlights:
  Secured mining workforce contract
  Advanced permitting
  Progressed lateral development on 6
   levels
  Significant progress in surface and
   underground construction work
  Refined mining plan based on
   recently completed studies of crown
   pillars, rock mechanics, and
   metallurgical tests

                                         32
Other Gold Properties:
GROWTH POTENTIAL

                                                               2011             Trucking
                                                                                                    Au Production
          Project                Resources*                 Exploration        Distance to
                                                                                                      Potential
                                                             Program             SG Mill

                         Measured & Indicated:
                         162,035 oz Au (1.80 g/t)                                                         TBD
          FLORDIN                                              4,500 m             70 Km
                         Inferred:                                                                (potential open pit)
                         97,651 oz Au (1.59 g/t)
                         Measured & Indicated:
                         237,000 oz Au (5.74 g/t)                                                      44,000 oz /yr
         DISCOVERY                                             8,000 m             80 Km
                         Inferred:                                                                      (over 4 yrs)
                         294,000 oz Au (5.93 g/t)
                                                                                                           TBD
          DORMEX                       TBD                     2,400 m           Adjacent           (potential fold of
                                                                                                     Sleeping Giant)

                 Potential to produce over 100,000 oz per year
                      from expanded Sleeping Giant mill

     *     See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred
           Resources. Report sources can be found in the appendix.
                                                                                                                       33

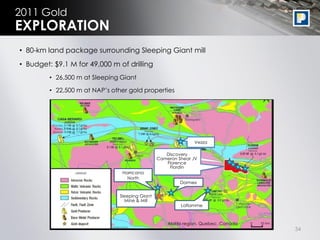

2011 Gold
EXPLORATION
• 80-km land package surrounding Sleeping Giant mill
• Budget: $9.1 M for 49,000 m of drilling
         • 26,500 m at Sleeping Giant

         • 22,500 m at NAP‟s other gold properties

                                                                Vezza

                                                    Discovery
                                                 Cameron Shear JV
                                                    Florence
                                                     Flordin
                                 Harricana
                                   North
                                                          Dormex

                                Sleeping Giant
                                  Mine & Mill
                                                          Laflamme

                                                     Abitibi region, Quebec, Canada
                                                                                      34

NAP 2011
PRIORITIES

 Priority                                                 Status
 Progressing the LDI mine expansion                       In Progress
 Completing the LDI resource update (Q2)                  Done
 Updating the LDI mine expansion plan (Q3)                Done
 Completing the shaft deepening at Sleeping Giant (Q2)    Done
 Advancing the Vezza gold project towards a production    In Progress
 decision (year-end)
 Continuing exploration programs aimed at increasing      In Progress
 reserves and resources at LDI and in the gold division
 Raising debt financing to fund LDI mine expansion (Q4)   Done

                                                                        35
Why
INVEST?

                        PIPELINE OF PROJECTS TO
      STRONG                INCREASE
  MANAGEMENT TEAM            PRODUCTION

  INVESTING IN FUTURE         FINANCIAL
      GROWTH               STRENGTH

                                                  36
Shareholder
INFORMATION
North American Palladium‟s vision is to build a mid-tier diversified precious metals company operating in mining
friendly jurisdictions. Highly leveraged to palladium, the Company is also building its exposure to gold, and is
focused on investing in its current operations to grow its production of palladium and gold. NAP‟s experienced
management and technical teams have a significant commitment to exploration and are dedicated to
building shareholder value.

                 Corporate Office:        Royal Bank Plaza, South Tower
                                          200 Bay St., Suite 2350
                                          Toronto, ON M5J 2J2

                     Stock Symbols:       NYSE Amex – PAL
                                          TSX – PDL

                              Website:    www.nap.com

                 Investor Relations:      Camilla Bartosiewicz
                                          Manager, Investor Relations & Corporate Communications
                                          camilla@nap.com
                                          416-360-7590 ext. 7226

                                                                                                               37
Appendices &
FURTHER INFORMATION

                   38
Senior
MANAGEMENT

    William J. Biggar – President and CEO
    An accomplished businessman with extensive experience in mining and in a broad range of industries. Mr. Biggar has held
    senior positions with Barrick Gold Corporation, Horsham Corporation and Magna International. He also has over 12 years of
    experience as an investment banker and private equity investor. A Chartered Accountant, he holds Master of Business
    Administration and Bachelor of Commerce (with distinction) degrees from the University of Toronto.

    Greg Struble – VP and COO
    A mine engineer with over 30 years of experience in underground mining. Most recently, he served as Executive Vice
    President and COO of Stillwater Mining Company, where he was responsible for two underground palladium mines as well as
    smelter and refinery operations. Prior to this, he worked as underground project manager for Barrick Gold‟s Cortez Hills Joint
    Venture. Mr. Struble has also worked internationally at a number of large gold mines.

    Jeff Swinoga – VP, Finance and CFO
    Eighteen years of experience in the resource, mining and finance industries. Mr. Swinoga has held CFO positions with HudBay
    Minerals and MagIndustries, and was Director, Treasury Finance of Barrick Gold Corporation for seven years. A Chartered
    Accountant, he also has an MBA from University of Toronto and an honours economics degree from University of Western
    Ontario.

    Trent Mell – VP, Corporate Development and General Counsel
    Mr. Mell has previously worked at the corporate head offices of Barrick Gold Corporation and Sherritt International. Prior to
    joining the mining industry, Mr. Mell worked with Stikeman Elliott LLP, where he practiced securities law. Mr. Mell has published
    papers on NI 43-101, and holds a B.A., a B.C.L. (with distinction) and a LL.B. (with distinction), all from McGill University, as well
    as a Masters degree in Securities Law from Osgoode Hall Law School.

                                                                                                                                    39
Cautionary Note to U.S. Investors Concerning
MINERAL RESERVES AND MINERAL RESOURCE

•   Mineral reserves and mineral resources have been calculated in accordance with National Instrument
    43-101 as required by Canadian securities regulatory authorities. For United States reporting purposes,
    Industry Guide 7, (under the Securities and Exchange Act of 1934), as interpreted by Staff of the Securities
    Exchange Commission (SEC), applies different standards in order to classify mineralization as a reserve. In
    addition, while the terms “measured”, “indicated” and “inferred” mineral resources are required pursuant
    to National Instrument 43-101, the U.S. Securities and Exchange Commission does not recognize such
    terms. Canadian standards differ significantly from the requirements of the SEC, and mineral resource
    information contained herein is not comparable to similar information regarding mineral reserves
    disclosed in accordance with the requirements of the U.S. Securities and Exchange Commission. U.S.
    investors should understand that “inferred” mineral resources have a great amount of uncertainty as to
    their existence and great uncertainty as to their economic and legal feasibility. In addition, U.S. investors
    are cautioned not to assume that any part or all of NAP's mineral resources constitute or will be
    converted into reserves. For a more detailed description of the key assumptions, parameters and
    methods used in calculating NAP‟s mineral reserves and mineral resources, see NAP‟s most recent Annual
    Information Form/Form 40-F on file with Canadian provincial securities regulatory authorities and the SEC.

• Michel Bouchard, P. Geo, a qualified person under NI 43-101, supervised the preparation of the technical
  data in this presentation.

• Please refer to North American Palladium‟s Annual Information Form for the year ended December 31,
  2010 and applicable technical reports available on www.sedar.com, www.sec.gov and www.nap.com
  for further information.
                                                                                                                40
LDI Mine
MINERAL RESERVES & RESOURCES
Roby Zone: May 31, 2010 & Offset Zone: December 31, 2010
                               Tonnes      Pd       Pt     Au     Ni     Cu           Pd
                               (000’s)   (g/t)   (g/t)   (g/t)   (%)    (%)    (000’s oz)

  RESERVES
    PROVEN - Roby Zone1,3         283     7.40   0.42    0.36    0.08   0.08          67
    PROBABLE - Roby Zone1,3       637     5.10   0.39    0.33    0.09   0.08         105
  Total Proven & Probable         920     5.81   0.40    0.34    0.08   0.08         172
  RESOURCES
    MEASURED
    Offset Zone1,2              2,500     5.62   0.36    0.33    0.12   0.09         452
    Open   Pit1,3               3,722     1.99   0.23    0.17    0.07   0.08         238
    Stockpile1,3                  508     2.21   0.20    0.18    0.07   0.05          36
  Total Measured                6,730     3.36   0.28    0.23    0.09   0.08         726
    INDICATED
    Offset Zone1,2             11,955     5.24   0.36    0.32    0.12   0.10       2,016
    Roby Zone1,3                3,144     7.62   0.44    0.33    0.08   0.06         770
    Open   Pit1,3               2,565     2.20   0.24    0.18    0.07   0.08         181
    Stockpile1,3               13,365    0.970   0.12    0.08    0.06   0.03         417
  Total Indicated              31,029     3.40   0.26    0.21    0.09   0.06       3,384
  Total Measured & Indicated   37,759     3.39   0.26    0.21    0.09   0.06       4,110
    INFERRED
    Offset Zone1,2              3,071     4.80   0.34    0.22    0.08   0.07         474

 See Notes on the next page.                                                                41
LDI Mine
MINERAL RESERVES & RESOURCES
NOTES:
1.Prepared in accordance with National Instrument 43-101 – Standards of Disclosure for Mineral Projects (“NI 43-101”) and the
  Canadian Institute of Mining, Metallurgy and Petroleum classification system.
2.The mineral resource estimate for the Offset Zone was prepared by Antoine Yassa, P.Geo. and Eugene Puritch, P.Eng. of P&E
  Mining Consultants Inc. both Independent Qualified Persons within the meaning of NI 43-101. The mineral resource calculation uses
  a minimum 3.5 g/t Pd resource block cut-off, Assays were capped at various levels depending on metal grade distributions.
  Resources were estimated to the 4070 Mine Level (-930 m elevation), a maximum depth of 1,430 m. The following metal price
  assumptions were used: US$475/oz palladium, US$1,500/oz platinum, US$1,100/oz gold, US$9.00/lb nickel, and US$3.00/lb copper. A
  US$/Cdn$ exchange rate of US$0.95 = CDN$1.00 was also applied.
3.The mineral reserve and resource estimate for the Roby Zone, open pit and and stockpiles were estimated as of June 30, 2010 by
  Scott Wilson RPA and updated by David Penna, P.Geo., an employee of the Company and a Qualified Person under 43-101 to: (i)
  to reflect additions to mineral reserves in the Roby Zone as a result of a lower cut-off palladium grade and higher palladium price
  in the Roby Zone; (ii) depletion from production up to May 31, 2011, and (iii) mineral reserves from the crown pillar (supported by an
  internal engineering report). The following cut-off grades were used: (i) 1.8 g/t PdEq for the Roby open pit, within an optimized pit
  shell run below the current pit survey; (ii) 1.9 g/t PdEq for the mine stockpiles; and (iii) 5.8 g/t PdEq for the underground Roby
  Zone. These cut-off grades were determined under the assumption that production would take place at a rate of 14,000
  tpd. Metal price assumptions of US$350/oz palladium, US$1,400/oz platinum, US$850/oz gold, US$6.50/lb nickel, and US$2.00/lb
  copper were used in the estimation of cut-off grade. A US$/Cdn$ exchange rate of 1.11 was also applied.
4.Palladium ounces are stated as contained ounces. Disclosure of contained ounces is permitted under Canadian regulations;
  however, the SEC generally permits resources to be reported only as in place tonnage and grade. Since the closure of the open
  pit operations, metallurgical recoveries at the LDI mine have been approximately 80.8% for palladium, 74.2% for platinum and
  77.2% for gold.
5.Mineral resources which are not mineral reserves do not have demonstrated economic viability. The estimate of mineral resources
  may be materially affected by environmental, permitting, legal, title, taxation, socio-political, marketing, or other relevant
  issues. The quantity and grade of reported inferred resources in this estimation are uncertain in nature and there has been
  insufficient exploration to define these Inferred resources as an Indicated or Measured mineral resource and it is uncertain if further
  exploration will result in upgrading them to an Indicated or Measured mineral resource category.
6.The resource estimate was prepared by constructing 3D wireframes containing 37.9 million tonnes of mineralization with Gemcom
  software and using inverse distance squared (1/d2) grade interpolation on capped composited assays.

                                                                                                                                       42

Sleeping Giant Mine
MINERAL RESERVES & RESOURCES
December 31, 2010

                                                                            Au                    Au
        Type                                         Tonnes               (g/t)       (Contained Oz.)
        RESERVES

            Proven                                     36,800               7.7                      9,100
            Probable                                  154,200               8.6                     42,600
            Proven & Probable                        191,000                8.4                     51,700
        RESOURCES
            Measured                                   15,400               5.9                      2,900
            Indicated                                 589,500               6.5                    123,000
            Measured & Indicated                     604,900                6.5                    125,800
            Inferred                                  146,000               8.2                     38,700

    NOTES:
    1. The mineral reserve and mineral resource estimate for the Sleeping Giant mine was prepared by Mr.
       Vincent Jourdain, P.Eng., Ph.D, Donald Trudel, P.Geo. and Marc-André Lavergne P.Eng., qualified persons
       under NI 43-101.
    2. Mineral resources are exclusive of mineral reserves.
    3. Mineral Resources are estimated at varying cut-off grades depending on the type of mining method
       contemplated.
    4. This updated mineral resource estimate assumes a long-term gold price of US $1,100.
    5. CIM definitions were followed for Mineral Resources. See Cautionary Note to U.S. Investors Concerning
       Estimates of Measured, Indicated and Inferred Resources.                                                  43
Vezza Project
MINERAL RESOURCES
December 31, 2010

                                                                                    Au                        Au
        Type                                                Tonnes                (g/t)           (Contained Oz.)
        RESOURCES

            Measured                                        190,000                  6.1                         37,100

            Indicated                                     1,524,000                  5.8                        283,800

            Total Measured & Indicated                    1,714,000                  5.8                        320,900
            Inferred                                        633,000                  5.0                        102,100

   NOTES :
   1. This updated mineral resource estimate was prepared as of April 11, 2011 by M. Bernard Salmon, B.Sc., Eng., an
      independent Qualified Person within the meaning of NI 43-101.
   2. CIM definitions were followed for the estimation of Mineral Resources.
   3. Mineral Resources are estimated at a cut-off grade of 3 g/t, using an average long-term gold price of US$1,200 per
      ounce and a US$/C$ exchange rate of 1:1.
   4. Minimum mining width of two metres was used.
   5. Totals may not represent the sum of the parts due to rounding.
   6. See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources.

                                                                                                                           44
Flordin Property
MINERAL RESOURCES
March 14, 2011

                                                                              Au                  Au
        Type                                           Tonnes               (g/t)     (Contained Oz.)
        RESOURCES

            Measured                                    116,200               3.25                   12,133

            Indicated                                 2,679,600               1.74                  149,902

            Total Measured & Indicated                2,795,800               1.80                 162,035

            Inferred                                  1,915,700               1.59                   97,651

   NOTES:
   1. This updated mineral resource estimate for a potential open pit mining method was prepared as of March 14,
      2011 by Mr. Pierre-Luc Richard, B.Sc., Geo. of InnovExplo Inc., an independent qualified person under NI 43-101,
      using a cut-off grade of 0.5 g/t and 3 metre minimum width.
   2. CIM definitions were followed for the estimation of mineral resources.
   3. See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources.

                                                                                                                         45

Discovery Project
MINERAL RESOURCES
August 1, 2008
                                                                                                          Au
                                                                                        Au        (Contained
           Type                                                 Tonnes                (g/t)          ounces)
           RESERVES
              Measured                                              3,000              8.95                   900
              Indicated                                        1,279,000               5.74              236,000
              Inferred                                         1,546,000               5.93              294,000

 NOTES:
 1. Source: NI 43-101 Technical Report, August 1, 2008
 2. The mineral resource estimate for the Discovery Project was prepared by Mr, Carl Pelletier, B.Sc., P.Geo. of InnovExplo, an
    independent qualified person under NI 43-101, assuming a gold price of U.S.$850 in the first 5 years, and U.S.$750
    thereafter. Applied varying cut-off grades depending on the type of mining method contemplated.
 3. The effective date of the estimate is June 17, 2008.
 4. This estimate conforms with National Instrument 43-101 – Standards of Disclosure for Mineral Projects (NI 43-101). U.S. investors
    should refer to the company‟s most recent 40F/Annual Information Form for an overview on how Canadian standards differ
    significantly from U.S. requirements. Mineral Resources, having demonstrated economic viability, are not Mineral Reserves.

    For further information, please refer to the report titled “Technical Report on the Scoping Study and Mineral Resource Estimate
    for the Discovery Project (according to Regulation 43-101 and Form 43-101F1) dated August 1, 2008 and prepared by
    InnovExplo Inc. It is filed on www.sedar.com under Cadiscor Resources Inc.

                                                                                                                                    46

Nap_new

  • 1.
    Investor November 2011 William J. Biggar PRESENTATION President & CEO
  • 2.
    Forward Looking STATEMENTS Certain informationincluded in this presentation, including any information as to our future production, exploration, financial or operating performance and other statements that express management's expectations or estimates of future performance, constitute „forward-looking statements‟ within the meaning of the „safe harbor‟ provisions of the United States Private Securities Litigation Reform Act of 1995 and Canadian securities laws. The words „expect‟, „believe‟, „will‟, „intend‟, „estimate‟ and similar expressions identify forward-looking statements. Forward-looking statements, including future-oriented financial information, are necessarily based upon a number of estimates and assumptions that, while considered reasonable by management, are inherently subject to significant business, economic and competitive uncertainties, risks and contingencies, including the possibility that operations at the Lac des Iles and Sleeping Giant mines may not proceed as planned, that other properties may not be successfully developed, and that metal prices, foreign exchange assumptions and operating costs may differ from management‟s expectations. The Company cautions the reader that such forward-looking statements involve known and unknown risks, uncertainties and other factors that may cause the actual financial results, performance or achievements of North American Palladium to be materially different from the Company‟s estimated future results, performance or achievements expressed or implied by those forward-looking statements and that the forward-looking statements are not guarantees of future performance. For more details on these estimates, risks, assumptions and factors, see the Company‟s most recent Form 40-F/Annual Information Form on file with the U.S. Securities and Exchange Commission and Canadian provincial securities regulatory authorities. The Company disclaims any obligation to update or revise any forward-looking statements, whether as a result of new information, events or otherwise, except as expressly required by law. Readers are cautioned not to put undue reliance on these forward-looking statements. All dollar amounts in Canadian currency unless otherwise stated, all references to production refer to payable production, and all reference to tonnes refer to metric tonnes. U.S. investors are encouraged to refer to the “Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources” in the appendix. 1
  • 3.
    Investment Case FOR NAP •Growth-oriented precious metals producer in mining-friendly jurisdictions: • LAC DES ILES, one of only two primary palladium mines in the world, transitioning into a long-life, low-cost operation • GOLD DIVISION provides foundation for growth • Robust pipeline of projects to increase palladium and gold production • Significant commitment to palladium and gold exploration • Experienced senior management and operating teams • Strong balance sheet to fund development programs 2
  • 4.
    Diversified Precious Metals PRODUCER LDI:  One of only two primary palladium mines in the world  Producing palladium since 1993  Transitioning into a long life, low cost mine  Significant exploration upside QUEBEC Sleeping Giant: ONTARIO VEZZA  Producing gold for over 20 years Gold Mine LAC DES ILES Palladium Mine SLEEPING GIANT  Growth potential at depth Gold Mine  Underutilized mill has potential to Timmins Val d‟Or serve NAP‟s nearby projects in Thunder Abitibi Bay Sudbury Montreal Vezza: Toronto  Currently being advanced to be “production ready” in Q1, 2012 3
  • 5.
    Market Statistics: A VERYLIQUID STOCK STOCK SYMBOLS NYSE Amex: PAL $9.00 TSX: PDL $8.00 $7.00 MARKET CAPITALIZATION US $567 M $6.00 $5.00 SHARE PRICE US $3.50 $4.00 $3.00 SHARES OUTSTANDING 162.4 M $2.00 52-WEEK HIGH/LOW US $7.92/$2.10 $1.00 $0.00 3-MONTH AVERAGE NYSE Amex: 2,137,952 TRADING VOLUME TSX: 358,997 Information as at Nov. 4, 2011, Thomson One. 4
  • 6.
    Market Statistics: STRONG STREETFOLLOWING ANALYST COVERAGE RBC Capital Markets Leon Esterhuizen Cormark Securities Rajiv Chail Scotia Capital Credit Suisse Leily Omoumi Nathan Littlewood Stifel Nicolaus GMP Securities George Topping Andrew Mikitchook Haywood Securities Chris Thompson TOP 5 INSTITUTIONAL INVESTORS Macquarie 1. RBC Global Asset Management Daniel Greenspan Merrill Lynch 2. T. Rowe Price Associates Michael Parkin 3. Mackenzie Financial Corporation Octagon Capital Annie Zhang 4. Chilton Investment Company Raymond James 5. Soros Fund Management Bart Jaworski 5
  • 7.
    Financial STRENGTH •$95.7 M in working capital (including $37.5 M in cash) as at Sept. 30, 2011 • $60 M operating line • $72 M term debt financing closed on Oct. 4, 2011 – Increasing Sept. 30, 2011 pro-forma cash to $110 M 6
  • 8.
  • 9.
    Palladium Market: MINE SUPPLY RUSSIA NORTH AMERICA 40% 9% ONLY 6.8 M oz. ANNUAL PRODUCTION WORLDWIDE SOUTH AFRICA 42% Source: CPM Group, June 2011 Note: Other producing countries (9%) include Zimbabwe, Australia, Botswana, China, Serbia and Montenegro; Excludes secondary supply of 1.7 M oz. 8
  • 10.
    Palladium Market: SUPPLY Constrained Mine Supply From Major Producers (000’s ounces) 3,500 Russia South Africa 3,000 2,500 2,000 1,500 1,000 500 0 2006 2007 2008 2009 2010 • Russian state stockpiles believed to be at or near exhaustion Source: CPM Group, June 2011 9
  • 11.
    Palladium Market: DEMAND 2010 Fabrication Demand: 7.5 M oz. Refining Dental Automotive 6% 10% Other 58% 3% Jewellery 7% Electronics 16% Source: CPM Group, June 2011 10
  • 12.
    Palladium Market: DEMAND Global Light Vehicle Production – 5 Year Forecast (000‟s) 97M 100M 100,000 92M 88M Other1 90,000 84M 80,000 72M 75M Europe 70,000 60,000 North 50,000 America 40,000 30,000 BRIC 20,000 Economies2 10,000 0 2010 2011 2012 2013 2014 2015 2016 (Actual) Source: IHS Global Insight Automotive, June 2011 1. Other includes: Japan, Korea, Middle East and Africa 2. BRIC Economies include: Greater China, South America and South Asia • Majority of demand derived from automobile sector for autocatalysts • Strongest growth in regions outside of North America, Europe and Japan 11
  • 13.
    Palladium Market: DEMAND Adoption of Stricter Emission Control Standards 2005 2006 2007 2008 2009 2010 2011 2012 2013 2014 2015 Europe Euro IV Euro V Euro VI Beijing Euro III Euro IV Euro V China Nationwide Euro II Euro III Euro IV Select Cities Euro III Euro IV India Nationwide Euro II Euro III Russia Euro I Euro II Euro III Euro IV Euro V USA Tier 2 and LEV II Brazil Prconve 3 Prconve 4 Prconve 5 Prconve 6 Japan Japan 05 Source: CPM Group, June 2011 • Emerging economies have adopted emission control standards that mandate the use of catalytic converters • Advancing to a higher level of emission controls results in higher PGM loadings in the catalytic converter • Tightening emission control regulations for heavy-duty trucks 12
  • 14.
    Use of Palladiumin CATALYTIC CONVERTERS Gasoline Engines Hybrids & Other New Forms • Use +90% palladium (of total required • Neutral impact on PGM use PGM content) • Gasoline hybrids tend to use as much palladium as normal gasoline engines Diesel Engines • Currently account for only 1% of global cars sales1 • Historically used platinum due to technical requirements • Forecasted to be 14% of overall market by 20202 • Currently use 25% palladium, with scope to increase to 50% due to advent of low sulphur diesel fuel Electric • No requirement for catalytic converters • Challenged by lack of infrastructure to recharge, high costs, long charging periods and short driving range • Forecasted to account for only 2% of global car sales by 20202 1. CPM Group, June 2010 2. Stefan Bratzel, director of the Centre of Automotive Management in Germany; as reported in Mitsui Global Precious Metals “Pole Position” Report, June 2010 13
  • 15.
    Palladium Market: DEMAND Exchange Traded Funds' Physical Palladium Holdings Thousand Ounces Thousand Ounces 2,500 2500 SPAL-LSE SPDM-LSE 2,000 WITE 2000 GLTR 1,500 Julius Baer 1500 MSL (Australia) PALL-NYSE 1,000 1000 Palladium ZKB PHPD -LSE 500 500 0 0 20-Apr-07 20-Jan-08 20-Oct-08 20-Jul-09 20-Apr-10 20-Jan-11 • Increasing investment demand driven by perceived positive supply/demand fundamentals for palladium and automotive industry outlook Source: CPM Group, as at October 5, 2011 14
  • 16.
    Palladium Market: INCREASING PRICE Recent performance of Palladium (US$/oz) Average Annual Price Forecast (US$/oz) $900.00 2011 2012 $800.00 BNP Paribas $860 $810 $700.00 CPM Group $849 $908 $600.00 JP Morgan $838 $938 $500.00 $400.00 Credit Suisse $803 $950 $300.00 Barclays $820 $860 $200.00 UBS $800 $825 $100.00 RBC Capital Markets $780 $850 $0.00 1/2/2008 1/2/2009 1/2/2010 1/2/2011 Historic High: US $1,090 (2001) Recent Price: US $651 (Nov. 4, 2011) YTD Average Price: US$746 Sources: Thomson One and available equity research. 15
  • 17.
  • 18.
    LDI: A WORLD CLASSMINE • One of only two primary palladium mines in the world • Open pit commenced operations in 1993 (now exhausted) • Underground mining from the Roby Zone (via ramp) began in 2006 • Total production of ~2.5 M oz of palladium (+ Pt, Au, Ni, Cu) since 1993 • Mine expansion underway with production from the Offset Zone (via shaft) targeted for Q4 2012 • 15,000 tpd underutilized mill • 200 employees 17 17
  • 19.
    LDI: OPERATING METRICS 2011 Q1 2011 Q2 2011 Q3 2011 YTD Forecast Payable Palladium 145,000 - 30,661 46,971 34,871 112,503 Production (oz) 155,000 Tonnes of Ore Mined 332,523 428,692 477,923 1,239,138 1,460,000 Avg. Head Grade 3.9 g/t 5.0 g/t 3.5 g/t 4.1 g/t 4.2 g/t Milled Palladium Mill 78.8% 83.2% 76.4% 79.7% 80% Recovery Cash Costs1 ($US/oz) $519 $335 $496 $436 $450 1. Total cash costs per ounce is a non-IFRS measure. For reconciliation of historical total cash costs per ounce to production costs, please refer to the Company‟s financial statements. Cash costs per ounce are presented net of byproduct credits and can be materially affected by changes in byproduct metal prices, as well as the Canadian/US dollar exchange rate. 18
  • 20.
    LDI: MINE EXPANSION PLAN •Transitioning from mining via ramp to via shaft Surface • High-volume, large scale bulk mining OPEN PIT method: – long-hole stoping with primary & ROBY secondary stoping blocks ZONE SHAFT • Currently sinking a shaft to the 4,815 mine level (700 m from surface) • Shaft is being sized for 7,000 tpd 685 Metres • Completion of Phase I of shaft scheduled for Q4, 2012 • Target shaft mining rate: OFFSET ZONE – 3,500 tpd (Q4 2012) – 5,500 tpd (Q1 2015) • Once mining at 5,500 tpd: 1,345 Metres – Production expected to exceed 250,000 oz/yr The underground design schematic of LDI, showing the deposit and – Cash costs are expected to decline to underground ramp infrastructure, looking east. ~US$200/oz 19
  • 21.
    LDI: MINE EXPANSION INPROGRESS HEAD FRAME ORE BIN HOIST HOUSE Sept. 28, 2011 • Est. Capex: $175 M in 2011, $75 M in 2012 • YTD Sept. 30, 2011 Capex: $99 M • Focus of 2011 Development Work: – Constructing the head frame, hoist room and electrical substation – Installing the service cage and production hoists – Completing the shaft raise bore & ventilation raise bore – Advancing the ramp towards the 4570 mine level – Developing the 4790 mine level in preparation for production 20
  • 22.
    LDI Mine Expansion: LOWEXECUTION RISK • Over 17 years of mining experience at LDI with a solid track record of underground development • Experienced 20-person development team on site overseeing all aspects of the expansion with the support of industry-leading contractors • Brownfield expansion vs. greenfield project • Utilizes existing Roby Zone development platform • Underutilized mill and tailings facilities in place • No long lead items • No capex currency risk (all expenditures are in C$) 21
  • 23.
    LDI: NEW UNDERGROUND ZONES Roby Zone Offset Zone Cowboy Zone Offset Cowboy Zone Outlaw Zone Zone Cross Section View Mineralization Extension Trend Other Cowboy & Outlaw Zones discovered in 2009 Sheriff Zone Mineralization Plan View Trend Offset Zone Sheriff Zone discovered in 2010 New zones have potential to increase production 22
  • 24.
    LDI: CONTINUING FOCUS ONEXPLORATION Growing Through the Drill Bit Significant 2011 Exploration Program*: • Budget: $8.8M • 32,000 m of drilling: – 25,000 m at LDI – 3,000 m at Legris Lake – 4,000 m at NAP‟s other nearby properties * Excludes 46,000 metres of expansion project drilling 23
  • 25.
    LDI: EXPLORATION UPSIDE NEARMINE +30,000-acre PGM land package North VT North Rim VT Rim Mineralized Trend North Pit LDI PROPERTY Target Legris Lake LDI Mine & Mill Legris Lake Sheriff LDI & Legris Lake cover the most Zone South Pit Target N prospective mafic complexes in the area • LDI represents a rare palladium-rich asset with excellent infrastructure • LDI complex has only been drilled in a 1km x 1km area & remains largely underexplored • Multiple targets identified for follow up exploration 24
  • 26.
    LDI Exploration Potential INDEPENDENTREVIEW • Independent exploration review of LDI property conducted by Revelation Geoscience, experts in PGE deposits • Key findings: – “Globally, there are few available advanced WE HAVE ONLY PGE exploration investment opportunities as SCRATCHED THE SURFACE attractive as LDI (technical quality risk, PGE focus).” – “Exploration opportunities at LDI are highly ranked in comparison to most advanced PGE properties on a global basis. Low overall risk given existing infrastructure and permitting. Clear path to expanding production.” – “Several areas on the Mine Block Intrusion have immediate potential for expanding the resource base. Offset Zone south extension, Cowboy, Outlaw & Sheriff zones. Good historical link between exploration spend and resource quality and size. Encouraged to continue with aggressive exploration.” 25
  • 27.
  • 28.
    Regional Portfolio 80-KM LANDPACKAGE Vezza Discovery Cameron Shear JV Flordin Florence Sleeping Giant Dormex Harricana North Laflamme Total Reserves & Contained Tonnes Au (g/t) Resources Ounces Proven & Probable 191,000 8.4 52,000 Localisation. Measured & Indicated 6,397,000 4.1 846,000 Simplified Geology Map. Inferred 4,241,000 3.9 533,000 OBJECTIVE: Achieve scale through organic growth Potential to produce +100,000 oz of Gold per Year 27
  • 29.
    Sleeping Giant MINE • 2011transition year while development at depth is completed • Operations and cost structure revised to focus on quality (grade) vs. quantity (tonnage) to improve profitability • 2011 gold production guidance: 15,000 – 20,000 oz. • 110 employees currently at mine & mill site 28
  • 30.
    Sleeping Giant: ECONOMICS TOIMPROVE AT DEPTH • 2011 mining focused on the areas around the 975 m elevation & above • Completed deepening the mine shaft by 200 m to 1175 m to gain access to 3 new higher grade mining levels • Development of new mining levels commenced • Expect to produce from the new mining levels at the start of 2012 resulting in improved profitability 200 m Deepening Longitudinal Section All depth references are in metres 29
  • 31.
    Sleeping Giant: UNDERUTILIZED CENTRALMILL Strategic Asset • Ability to serve NAP‟s other gold projects in Abitibi region • 900 tpd mill currently operating at ½ capacity – Future plans for expansion to1,250 tpd or 1,750 tpd • In 2011, the Company will spend ~$2 M on the expansion, which includes: – geotechnical tests – building & foundation designs – detailed engineering work – receiving the required construction permits – materials procurement, including refurbished rod mill & jaw crusher 30
  • 32.
    Vezza Gold Project DEVELOPMENT •85 km by paved road to SG mill • Advanced-stage project: – Extensive drilling (+100,000 m) – Hoist & 3-compartment shaft – 4 underground levels down to a depth of 741 m – Surface infrastructure in place Production Potential: 39,000 oz/yr Mining Rate: 750 tpd • 2011 exploration & development capex budget: Mine Life: 9 years $32M • YTD Sept. 30, 2011 capex: $21 M • 40,000-tonne bulk sample to be processed at SG mill planned for Q4, 2011/Q1, 2012 • Being advanced to be “production ready” in Q1, 2012 31
  • 33.
    Vezza Gold Project DEVELOPMENT 2011 YTD Highlights:  Secured mining workforce contract  Advanced permitting  Progressed lateral development on 6 levels  Significant progress in surface and underground construction work  Refined mining plan based on recently completed studies of crown pillars, rock mechanics, and metallurgical tests 32
  • 34.
    Other Gold Properties: GROWTHPOTENTIAL 2011 Trucking Au Production Project Resources* Exploration Distance to Potential Program SG Mill Measured & Indicated: 162,035 oz Au (1.80 g/t) TBD FLORDIN 4,500 m 70 Km Inferred: (potential open pit) 97,651 oz Au (1.59 g/t) Measured & Indicated: 237,000 oz Au (5.74 g/t) 44,000 oz /yr DISCOVERY 8,000 m 80 Km Inferred: (over 4 yrs) 294,000 oz Au (5.93 g/t) TBD DORMEX TBD 2,400 m Adjacent (potential fold of Sleeping Giant) Potential to produce over 100,000 oz per year from expanded Sleeping Giant mill * See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources. Report sources can be found in the appendix. 33
  • 35.
    2011 Gold EXPLORATION • 80-kmland package surrounding Sleeping Giant mill • Budget: $9.1 M for 49,000 m of drilling • 26,500 m at Sleeping Giant • 22,500 m at NAP‟s other gold properties Vezza Discovery Cameron Shear JV Florence Flordin Harricana North Dormex Sleeping Giant Mine & Mill Laflamme Abitibi region, Quebec, Canada 34
  • 36.
    NAP 2011 PRIORITIES Priority Status Progressing the LDI mine expansion In Progress Completing the LDI resource update (Q2) Done Updating the LDI mine expansion plan (Q3) Done Completing the shaft deepening at Sleeping Giant (Q2) Done Advancing the Vezza gold project towards a production In Progress decision (year-end) Continuing exploration programs aimed at increasing In Progress reserves and resources at LDI and in the gold division Raising debt financing to fund LDI mine expansion (Q4) Done 35
  • 37.
    Why INVEST? PIPELINE OF PROJECTS TO STRONG INCREASE MANAGEMENT TEAM PRODUCTION INVESTING IN FUTURE FINANCIAL GROWTH STRENGTH 36
  • 38.
    Shareholder INFORMATION North American Palladium‟svision is to build a mid-tier diversified precious metals company operating in mining friendly jurisdictions. Highly leveraged to palladium, the Company is also building its exposure to gold, and is focused on investing in its current operations to grow its production of palladium and gold. NAP‟s experienced management and technical teams have a significant commitment to exploration and are dedicated to building shareholder value. Corporate Office: Royal Bank Plaza, South Tower 200 Bay St., Suite 2350 Toronto, ON M5J 2J2 Stock Symbols: NYSE Amex – PAL TSX – PDL Website: www.nap.com Investor Relations: Camilla Bartosiewicz Manager, Investor Relations & Corporate Communications camilla@nap.com 416-360-7590 ext. 7226 37
  • 39.
  • 40.
    Senior MANAGEMENT William J. Biggar – President and CEO An accomplished businessman with extensive experience in mining and in a broad range of industries. Mr. Biggar has held senior positions with Barrick Gold Corporation, Horsham Corporation and Magna International. He also has over 12 years of experience as an investment banker and private equity investor. A Chartered Accountant, he holds Master of Business Administration and Bachelor of Commerce (with distinction) degrees from the University of Toronto. Greg Struble – VP and COO A mine engineer with over 30 years of experience in underground mining. Most recently, he served as Executive Vice President and COO of Stillwater Mining Company, where he was responsible for two underground palladium mines as well as smelter and refinery operations. Prior to this, he worked as underground project manager for Barrick Gold‟s Cortez Hills Joint Venture. Mr. Struble has also worked internationally at a number of large gold mines. Jeff Swinoga – VP, Finance and CFO Eighteen years of experience in the resource, mining and finance industries. Mr. Swinoga has held CFO positions with HudBay Minerals and MagIndustries, and was Director, Treasury Finance of Barrick Gold Corporation for seven years. A Chartered Accountant, he also has an MBA from University of Toronto and an honours economics degree from University of Western Ontario. Trent Mell – VP, Corporate Development and General Counsel Mr. Mell has previously worked at the corporate head offices of Barrick Gold Corporation and Sherritt International. Prior to joining the mining industry, Mr. Mell worked with Stikeman Elliott LLP, where he practiced securities law. Mr. Mell has published papers on NI 43-101, and holds a B.A., a B.C.L. (with distinction) and a LL.B. (with distinction), all from McGill University, as well as a Masters degree in Securities Law from Osgoode Hall Law School. 39
  • 41.
    Cautionary Note toU.S. Investors Concerning MINERAL RESERVES AND MINERAL RESOURCE • Mineral reserves and mineral resources have been calculated in accordance with National Instrument 43-101 as required by Canadian securities regulatory authorities. For United States reporting purposes, Industry Guide 7, (under the Securities and Exchange Act of 1934), as interpreted by Staff of the Securities Exchange Commission (SEC), applies different standards in order to classify mineralization as a reserve. In addition, while the terms “measured”, “indicated” and “inferred” mineral resources are required pursuant to National Instrument 43-101, the U.S. Securities and Exchange Commission does not recognize such terms. Canadian standards differ significantly from the requirements of the SEC, and mineral resource information contained herein is not comparable to similar information regarding mineral reserves disclosed in accordance with the requirements of the U.S. Securities and Exchange Commission. U.S. investors should understand that “inferred” mineral resources have a great amount of uncertainty as to their existence and great uncertainty as to their economic and legal feasibility. In addition, U.S. investors are cautioned not to assume that any part or all of NAP's mineral resources constitute or will be converted into reserves. For a more detailed description of the key assumptions, parameters and methods used in calculating NAP‟s mineral reserves and mineral resources, see NAP‟s most recent Annual Information Form/Form 40-F on file with Canadian provincial securities regulatory authorities and the SEC. • Michel Bouchard, P. Geo, a qualified person under NI 43-101, supervised the preparation of the technical data in this presentation. • Please refer to North American Palladium‟s Annual Information Form for the year ended December 31, 2010 and applicable technical reports available on www.sedar.com, www.sec.gov and www.nap.com for further information. 40
  • 42.
    LDI Mine MINERAL RESERVES& RESOURCES Roby Zone: May 31, 2010 & Offset Zone: December 31, 2010 Tonnes Pd Pt Au Ni Cu Pd (000’s) (g/t) (g/t) (g/t) (%) (%) (000’s oz) RESERVES PROVEN - Roby Zone1,3 283 7.40 0.42 0.36 0.08 0.08 67 PROBABLE - Roby Zone1,3 637 5.10 0.39 0.33 0.09 0.08 105 Total Proven & Probable 920 5.81 0.40 0.34 0.08 0.08 172 RESOURCES MEASURED Offset Zone1,2 2,500 5.62 0.36 0.33 0.12 0.09 452 Open Pit1,3 3,722 1.99 0.23 0.17 0.07 0.08 238 Stockpile1,3 508 2.21 0.20 0.18 0.07 0.05 36 Total Measured 6,730 3.36 0.28 0.23 0.09 0.08 726 INDICATED Offset Zone1,2 11,955 5.24 0.36 0.32 0.12 0.10 2,016 Roby Zone1,3 3,144 7.62 0.44 0.33 0.08 0.06 770 Open Pit1,3 2,565 2.20 0.24 0.18 0.07 0.08 181 Stockpile1,3 13,365 0.970 0.12 0.08 0.06 0.03 417 Total Indicated 31,029 3.40 0.26 0.21 0.09 0.06 3,384 Total Measured & Indicated 37,759 3.39 0.26 0.21 0.09 0.06 4,110 INFERRED Offset Zone1,2 3,071 4.80 0.34 0.22 0.08 0.07 474 See Notes on the next page. 41
  • 43.
    LDI Mine MINERAL RESERVES& RESOURCES NOTES: 1.Prepared in accordance with National Instrument 43-101 – Standards of Disclosure for Mineral Projects (“NI 43-101”) and the Canadian Institute of Mining, Metallurgy and Petroleum classification system. 2.The mineral resource estimate for the Offset Zone was prepared by Antoine Yassa, P.Geo. and Eugene Puritch, P.Eng. of P&E Mining Consultants Inc. both Independent Qualified Persons within the meaning of NI 43-101. The mineral resource calculation uses a minimum 3.5 g/t Pd resource block cut-off, Assays were capped at various levels depending on metal grade distributions. Resources were estimated to the 4070 Mine Level (-930 m elevation), a maximum depth of 1,430 m. The following metal price assumptions were used: US$475/oz palladium, US$1,500/oz platinum, US$1,100/oz gold, US$9.00/lb nickel, and US$3.00/lb copper. A US$/Cdn$ exchange rate of US$0.95 = CDN$1.00 was also applied. 3.The mineral reserve and resource estimate for the Roby Zone, open pit and and stockpiles were estimated as of June 30, 2010 by Scott Wilson RPA and updated by David Penna, P.Geo., an employee of the Company and a Qualified Person under 43-101 to: (i) to reflect additions to mineral reserves in the Roby Zone as a result of a lower cut-off palladium grade and higher palladium price in the Roby Zone; (ii) depletion from production up to May 31, 2011, and (iii) mineral reserves from the crown pillar (supported by an internal engineering report). The following cut-off grades were used: (i) 1.8 g/t PdEq for the Roby open pit, within an optimized pit shell run below the current pit survey; (ii) 1.9 g/t PdEq for the mine stockpiles; and (iii) 5.8 g/t PdEq for the underground Roby Zone. These cut-off grades were determined under the assumption that production would take place at a rate of 14,000 tpd. Metal price assumptions of US$350/oz palladium, US$1,400/oz platinum, US$850/oz gold, US$6.50/lb nickel, and US$2.00/lb copper were used in the estimation of cut-off grade. A US$/Cdn$ exchange rate of 1.11 was also applied. 4.Palladium ounces are stated as contained ounces. Disclosure of contained ounces is permitted under Canadian regulations; however, the SEC generally permits resources to be reported only as in place tonnage and grade. Since the closure of the open pit operations, metallurgical recoveries at the LDI mine have been approximately 80.8% for palladium, 74.2% for platinum and 77.2% for gold. 5.Mineral resources which are not mineral reserves do not have demonstrated economic viability. The estimate of mineral resources may be materially affected by environmental, permitting, legal, title, taxation, socio-political, marketing, or other relevant issues. The quantity and grade of reported inferred resources in this estimation are uncertain in nature and there has been insufficient exploration to define these Inferred resources as an Indicated or Measured mineral resource and it is uncertain if further exploration will result in upgrading them to an Indicated or Measured mineral resource category. 6.The resource estimate was prepared by constructing 3D wireframes containing 37.9 million tonnes of mineralization with Gemcom software and using inverse distance squared (1/d2) grade interpolation on capped composited assays. 42
  • 44.
    Sleeping Giant Mine MINERALRESERVES & RESOURCES December 31, 2010 Au Au Type Tonnes (g/t) (Contained Oz.) RESERVES Proven 36,800 7.7 9,100 Probable 154,200 8.6 42,600 Proven & Probable 191,000 8.4 51,700 RESOURCES Measured 15,400 5.9 2,900 Indicated 589,500 6.5 123,000 Measured & Indicated 604,900 6.5 125,800 Inferred 146,000 8.2 38,700 NOTES: 1. The mineral reserve and mineral resource estimate for the Sleeping Giant mine was prepared by Mr. Vincent Jourdain, P.Eng., Ph.D, Donald Trudel, P.Geo. and Marc-André Lavergne P.Eng., qualified persons under NI 43-101. 2. Mineral resources are exclusive of mineral reserves. 3. Mineral Resources are estimated at varying cut-off grades depending on the type of mining method contemplated. 4. This updated mineral resource estimate assumes a long-term gold price of US $1,100. 5. CIM definitions were followed for Mineral Resources. See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources. 43
  • 45.
    Vezza Project MINERAL RESOURCES December31, 2010 Au Au Type Tonnes (g/t) (Contained Oz.) RESOURCES Measured 190,000 6.1 37,100 Indicated 1,524,000 5.8 283,800 Total Measured & Indicated 1,714,000 5.8 320,900 Inferred 633,000 5.0 102,100 NOTES : 1. This updated mineral resource estimate was prepared as of April 11, 2011 by M. Bernard Salmon, B.Sc., Eng., an independent Qualified Person within the meaning of NI 43-101. 2. CIM definitions were followed for the estimation of Mineral Resources. 3. Mineral Resources are estimated at a cut-off grade of 3 g/t, using an average long-term gold price of US$1,200 per ounce and a US$/C$ exchange rate of 1:1. 4. Minimum mining width of two metres was used. 5. Totals may not represent the sum of the parts due to rounding. 6. See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources. 44
  • 46.
    Flordin Property MINERAL RESOURCES March14, 2011 Au Au Type Tonnes (g/t) (Contained Oz.) RESOURCES Measured 116,200 3.25 12,133 Indicated 2,679,600 1.74 149,902 Total Measured & Indicated 2,795,800 1.80 162,035 Inferred 1,915,700 1.59 97,651 NOTES: 1. This updated mineral resource estimate for a potential open pit mining method was prepared as of March 14, 2011 by Mr. Pierre-Luc Richard, B.Sc., Geo. of InnovExplo Inc., an independent qualified person under NI 43-101, using a cut-off grade of 0.5 g/t and 3 metre minimum width. 2. CIM definitions were followed for the estimation of mineral resources. 3. See Cautionary Note to U.S. Investors Concerning Estimates of Measured, Indicated and Inferred Resources. 45
  • 47.
    Discovery Project MINERAL RESOURCES August1, 2008 Au Au (Contained Type Tonnes (g/t) ounces) RESERVES Measured 3,000 8.95 900 Indicated 1,279,000 5.74 236,000 Inferred 1,546,000 5.93 294,000 NOTES: 1. Source: NI 43-101 Technical Report, August 1, 2008 2. The mineral resource estimate for the Discovery Project was prepared by Mr, Carl Pelletier, B.Sc., P.Geo. of InnovExplo, an independent qualified person under NI 43-101, assuming a gold price of U.S.$850 in the first 5 years, and U.S.$750 thereafter. Applied varying cut-off grades depending on the type of mining method contemplated. 3. The effective date of the estimate is June 17, 2008. 4. This estimate conforms with National Instrument 43-101 – Standards of Disclosure for Mineral Projects (NI 43-101). U.S. investors should refer to the company‟s most recent 40F/Annual Information Form for an overview on how Canadian standards differ significantly from U.S. requirements. Mineral Resources, having demonstrated economic viability, are not Mineral Reserves. For further information, please refer to the report titled “Technical Report on the Scoping Study and Mineral Resource Estimate for the Discovery Project (according to Regulation 43-101 and Form 43-101F1) dated August 1, 2008 and prepared by InnovExplo Inc. It is filed on www.sedar.com under Cadiscor Resources Inc. 46
