Scrum Metrics for Hyper-Productive Teams: How They Fly like Fighter AircraftBy Jeff Sutherland and Scott Downey
Scrum Metrics for Hyper-Productive Teams: How They Fly like Fighter AircraftBy Jeff Sutherland and Scott Downey
What’s AheadGoalTuning the Scrum MeetingsMetrics:  Math and PurposeThe RoboScrum Workbook
What’s AheadGoalTuning the Scrum MeetingsMetrics:  Math and PurposeThe RoboScrum Workbook

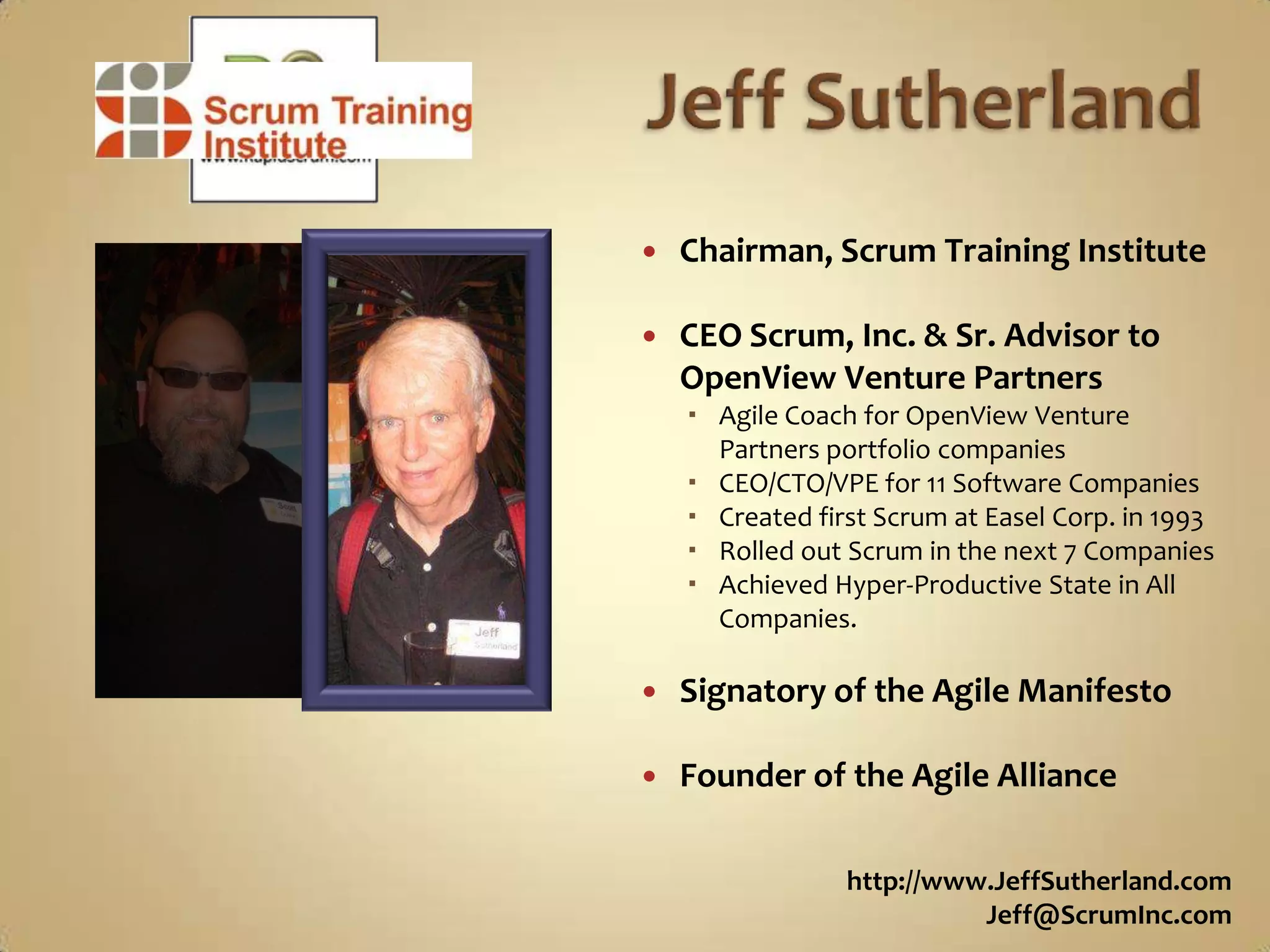

Jeff SutherlandChairman, Scrum Training InstituteCEO Scrum, Inc. & Sr. Advisor toOpenView Venture PartnersAgile Coach for OpenView Venture Partners portfolio companiesCEO/CTO/VPE for 11 Software CompaniesCreated first Scrum at Easel Corp. in 1993Rolled out Scrum in the next 7 CompaniesAchieved Hyper-Productive State in All Companies.Signatory of the Agile ManifestoFounder of the Agile Alliancehttp://www.JeffSutherland.comJeff@ScrumInc.com
Jeff SutherlandChairman, Scrum Training InstituteCEO Scrum, Inc. & Sr. Advisor toOpenView Venture PartnersAgile Coach for OpenView Venture Partners portfolio companiesCEO/CTO/VPE for 11 Software CompaniesCreated first Scrum at Easel Corp. in 1993Rolled out Scrum in the next 7 CompaniesAchieved Hyper-Productive State in All Companies.Signatory of the Agile ManifestoFounder of the Agile Alliancehttp://www.JeffSutherland.comJeff@ScrumInc.com
Scott DowneyHead Agile Coach, NapsterFormerly Head Agile Coach, MySpace68 Delivery TeamsCreated Immersive Scrum Training System for Rapid Bootstrapping of Hyper-Productive TeamsAverage Improvement was over 600%Average Boot-Up took only 4.5 WeeksCo-Teaching CSM with Jeff since 2007Shock Therapy:  A Bootstrap for Hyper-Productive Scrumat Agile ‘09 with Jeff and Björn Granvikhttp://www.RapidScrum.comScott@RapidScrum.com
Scott DowneyHead Agile Coach, NapsterFormerly Head Agile Coach, MySpaceMySpace had 68 Delivery TeamsCreated Immersive Scrum Training System for Rapid Bootstrapping of Hyper-Productive TeamsAverage Improvement was over 600%Average Boot-Up took only 4.5 WeeksCo-Teaching CSM with Jeff since 2007Shock Therapy:  A Bootstrap for Hyper-Productive Scrumat Agile ‘09 with Jeff and BjörnGranvikhttp://www.RapidScrum.comScott@RapidScrum.com

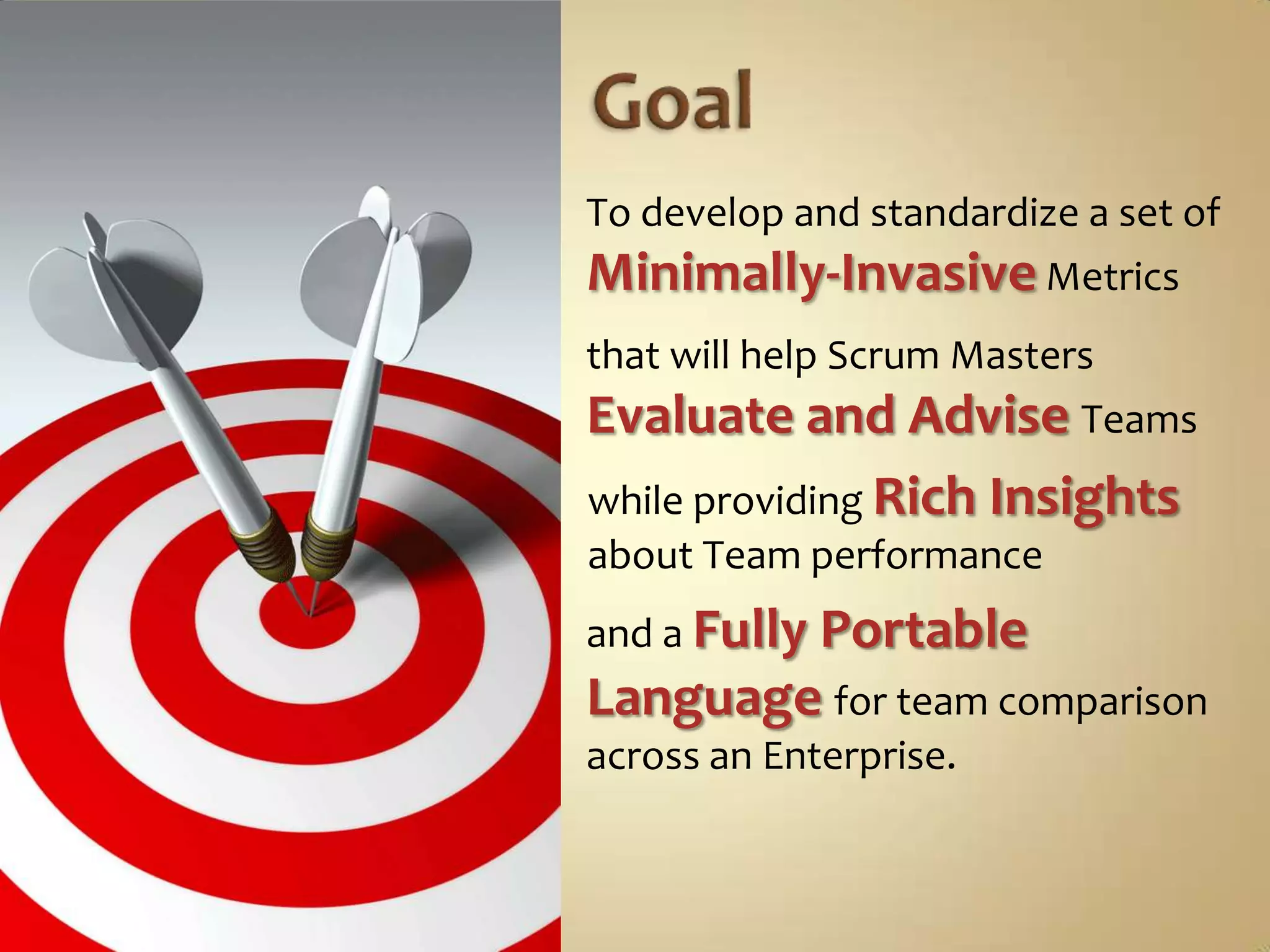

GoalTo develop and standardize a set of Minimally-InvasiveMetricsthat will help Scrum Masters Evaluate and AdviseTeamswhile providing Rich Insights about Team performanceand a Fully PortableLanguage for team comparison across an Enterprise.

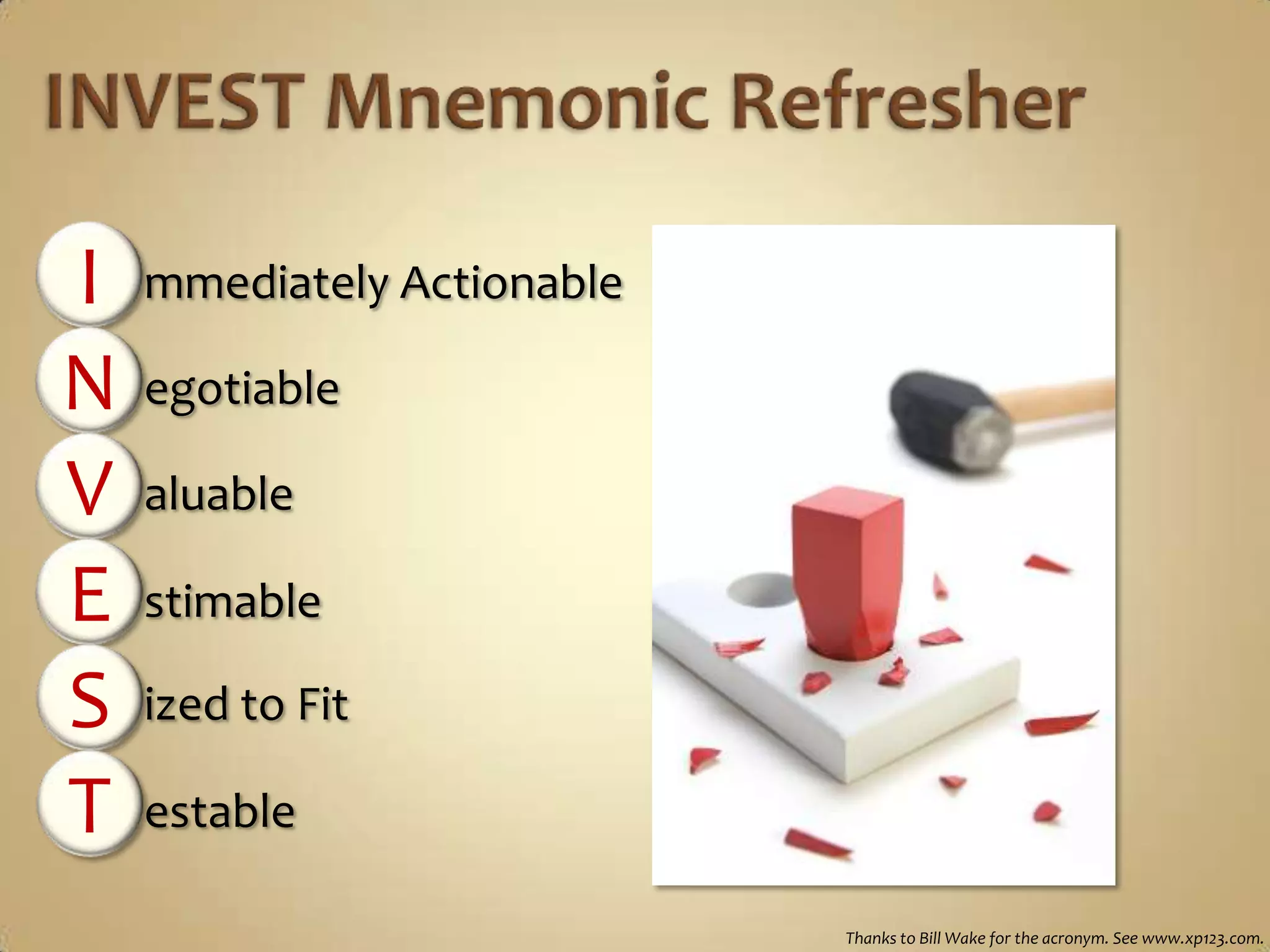

INVEST Mnemonic RefresherImmediately ActionableNegotiableValuableEstimableSized to FitTestableThanks to Bill Wake for the acronym. See www.xp123.com.

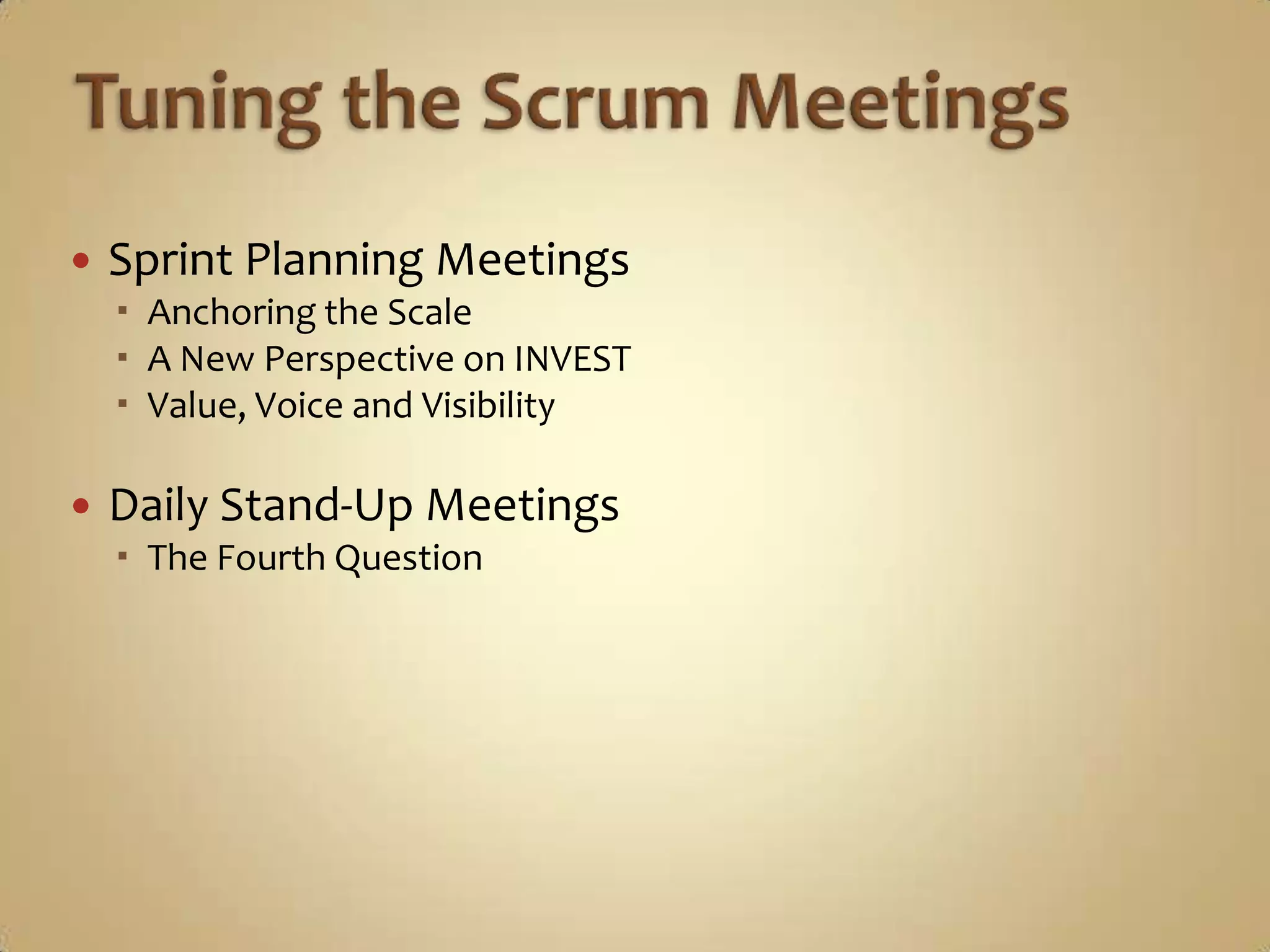

Tuning the Scrum MeetingsCreating a Culture of Hyper-Productivity
Tuning the Scrum MeetingsCreating a Culture of Hyper-Productivity

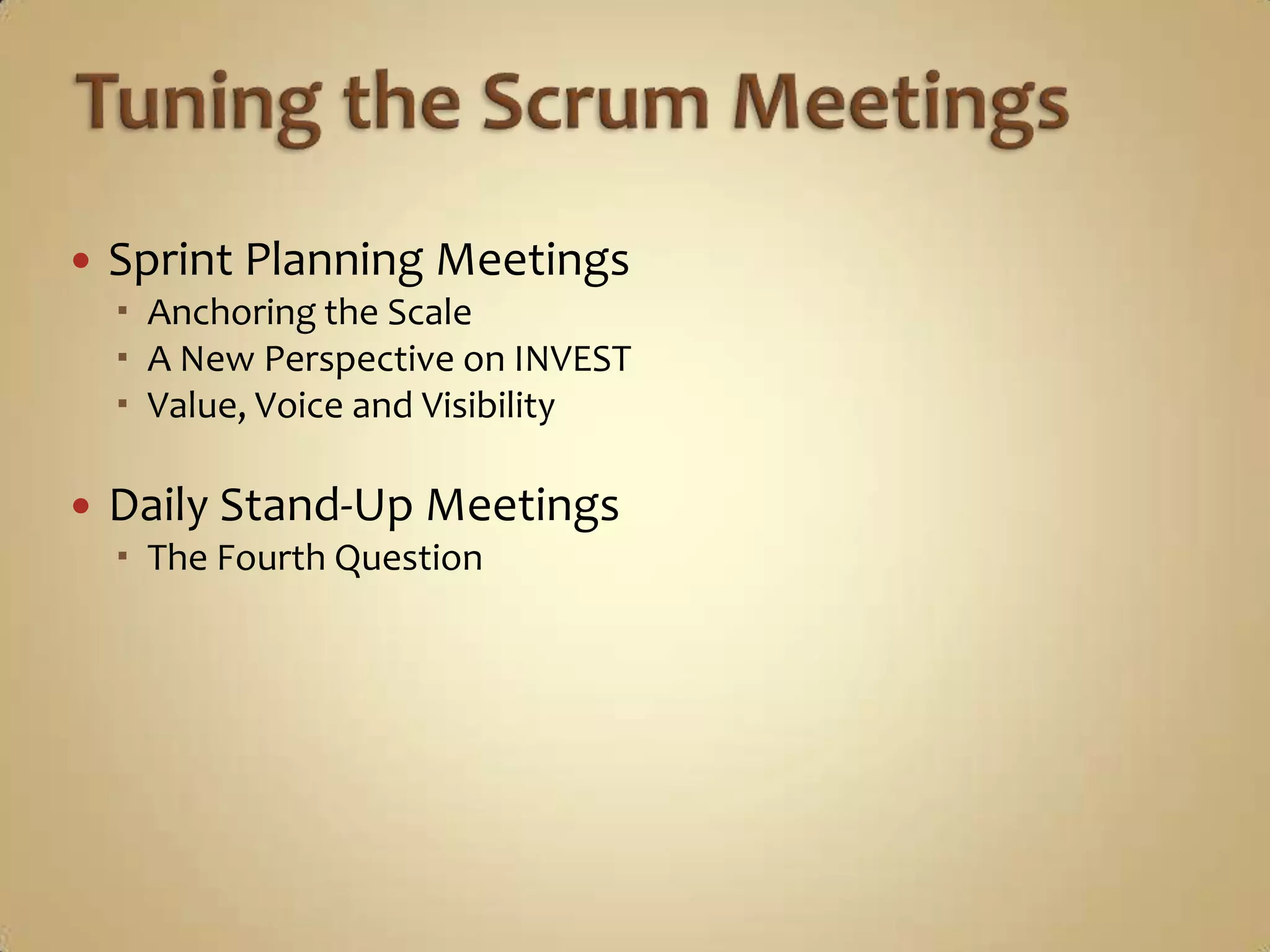

Tuning the Scrum MeetingsSprint Planning MeetingsAnchoring the ScaleA New Perspective on INVESTValue, Voice and VisibilityDaily Stand-Up MeetingsThe Fourth Question
Tuning the Scrum MeetingsSprint Planning MeetingsAnchoring the ScaleA New Perspective on INVESTValue, Voice and VisibilityDaily Stand-Up MeetingsThe Fourth QuestionSprint Planning MeetingsSprint Planning MeetingsKeystone:  A central cohesive source of support and stability;The architectural piece that locks other pieces into position;  That which provides structural integrity.Tuning the Scrum Meetings

Sprint Planning MeetingsThat’s the most important.Priority 1DeliveryTeamPriority 2Tuning the Scrum MeetingsPriority 3SPO

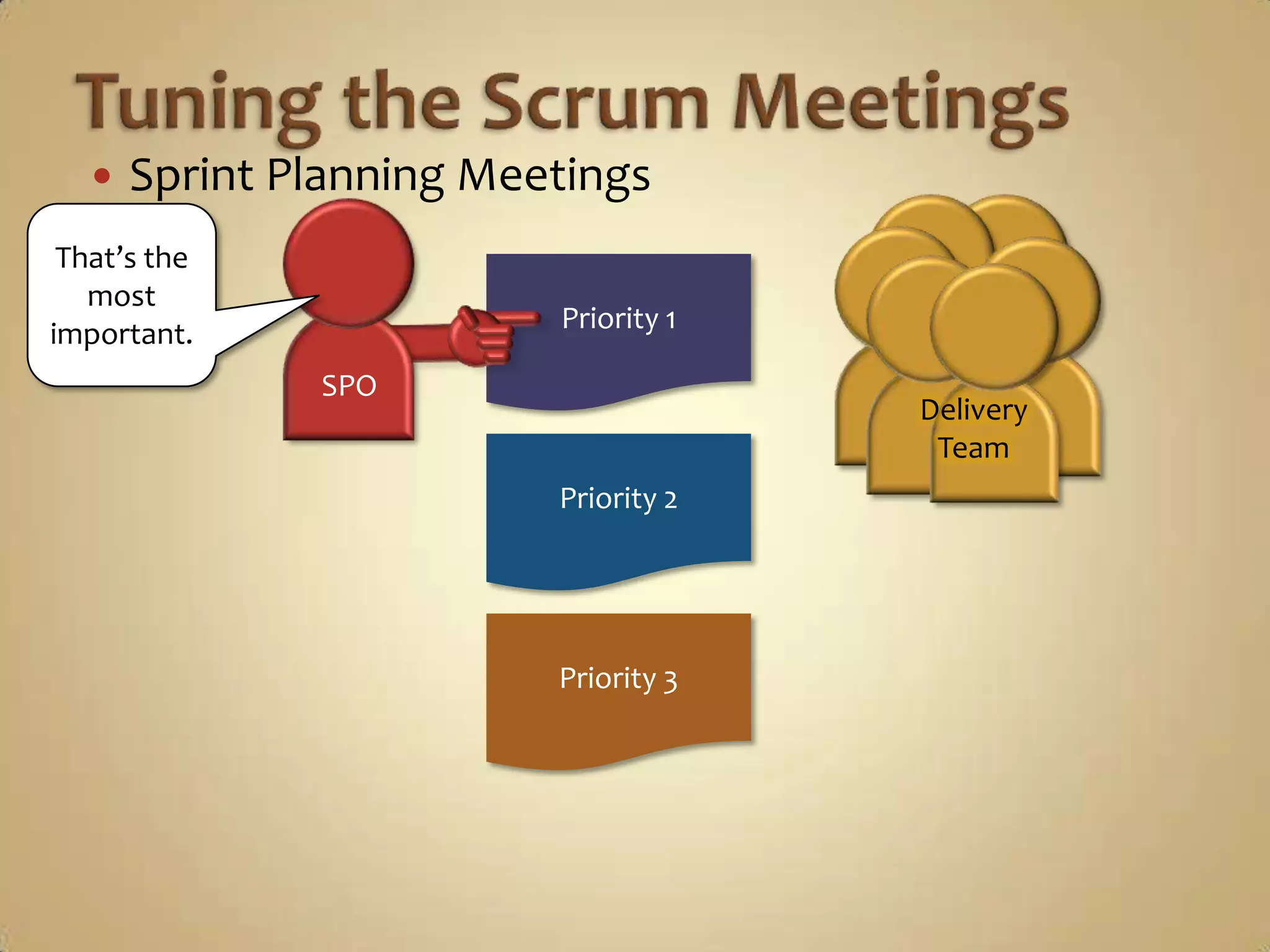

Tuning the Scrum MeetingsThat’s the easiest.Sprint Planning MeetingsPriority 1DeliveryTeamPriority 2Priority 3SPODeliveryTeam

Sprint Planning MeetingsTuning the Scrum MeetingsThat’s a 3.Priority 23DeliveryTeamPriority 3Scrum MasterPriority 1SPO
Sprint Planning MeetingsTuning the Scrum Meetings3Priority 2DeliveryTeamPriority 3SPOPriority 1

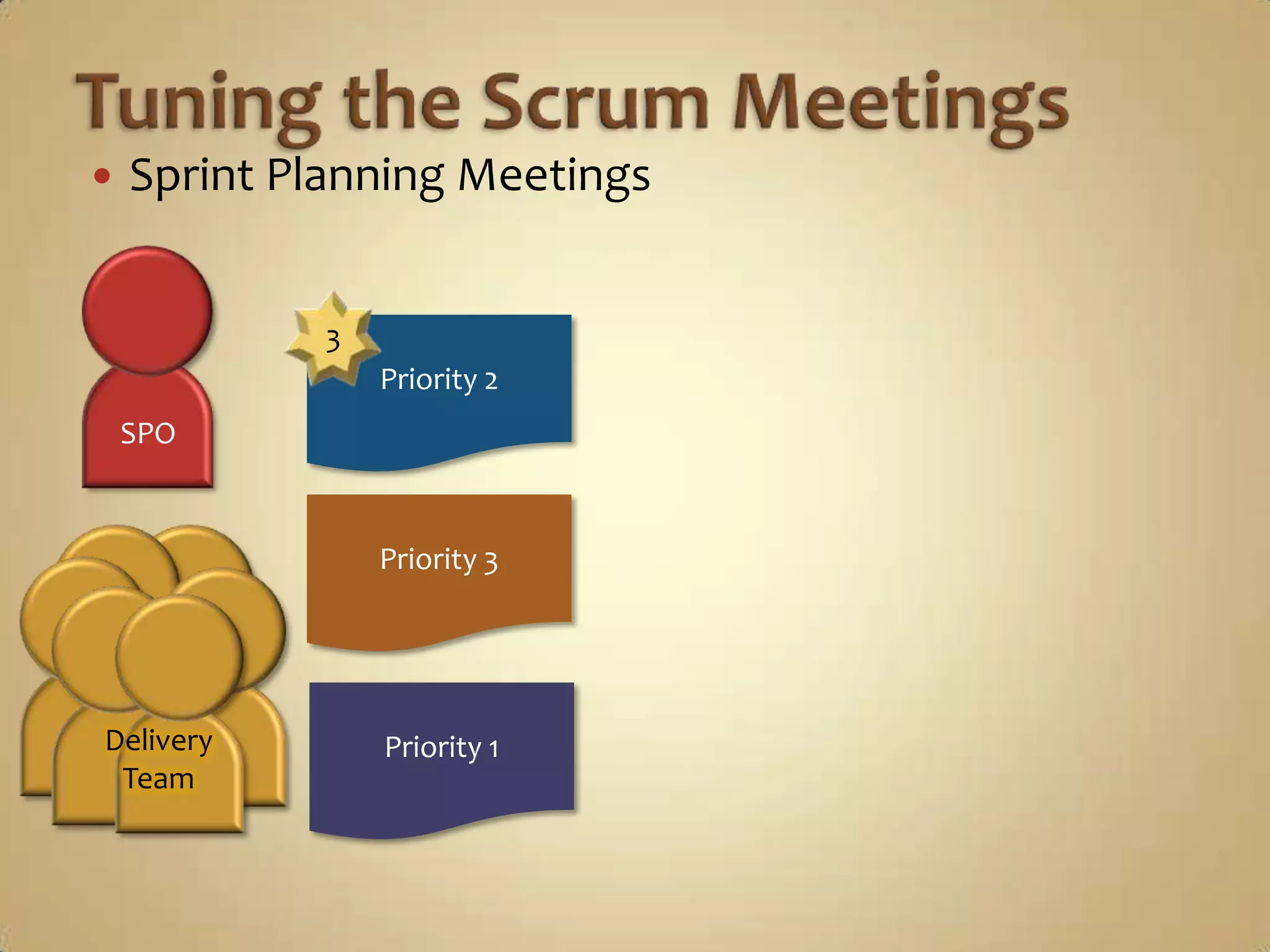

Sprint Planning Meetings3Priority 2DeliveryTeamTuning the Scrum Meetings58Priority 33Priority 1SPO
Sprint Planning MeetingsTuning the Scrum Meetings3
Sprint Planning MeetingsTuning the Scrum Meetings33%100%66%167%267%433%1	2	3	5	8	13
Sprint Planning MeetingsTuning the Scrum Meetings100%66%33%167%267%433%1	2	3	5	8	13	21	34	551	2	3	5	8	13	34	55PBLSBLBankDo you Approve?Yes.DeliveryTeam21Do you Approve?Yes.5!@#$%^&Do you Approve?No.13Do you Approve?Yes.3Do you Approve?Yes.SPO8

Sprint Planning MeetingsTuning the Scrum Meetings100%66%33%167%267%433%700%1	2	3	5	8	13	21	34	551	2	3	5	8	13	21	34	55PBLSBLBankYes.Can you do this?DeliveryTeam821Yes.Can you do this?35No, it’s not Actionable.Can you do this?#$%@!#$5133Yes.Can you do this?8SPOINVEST

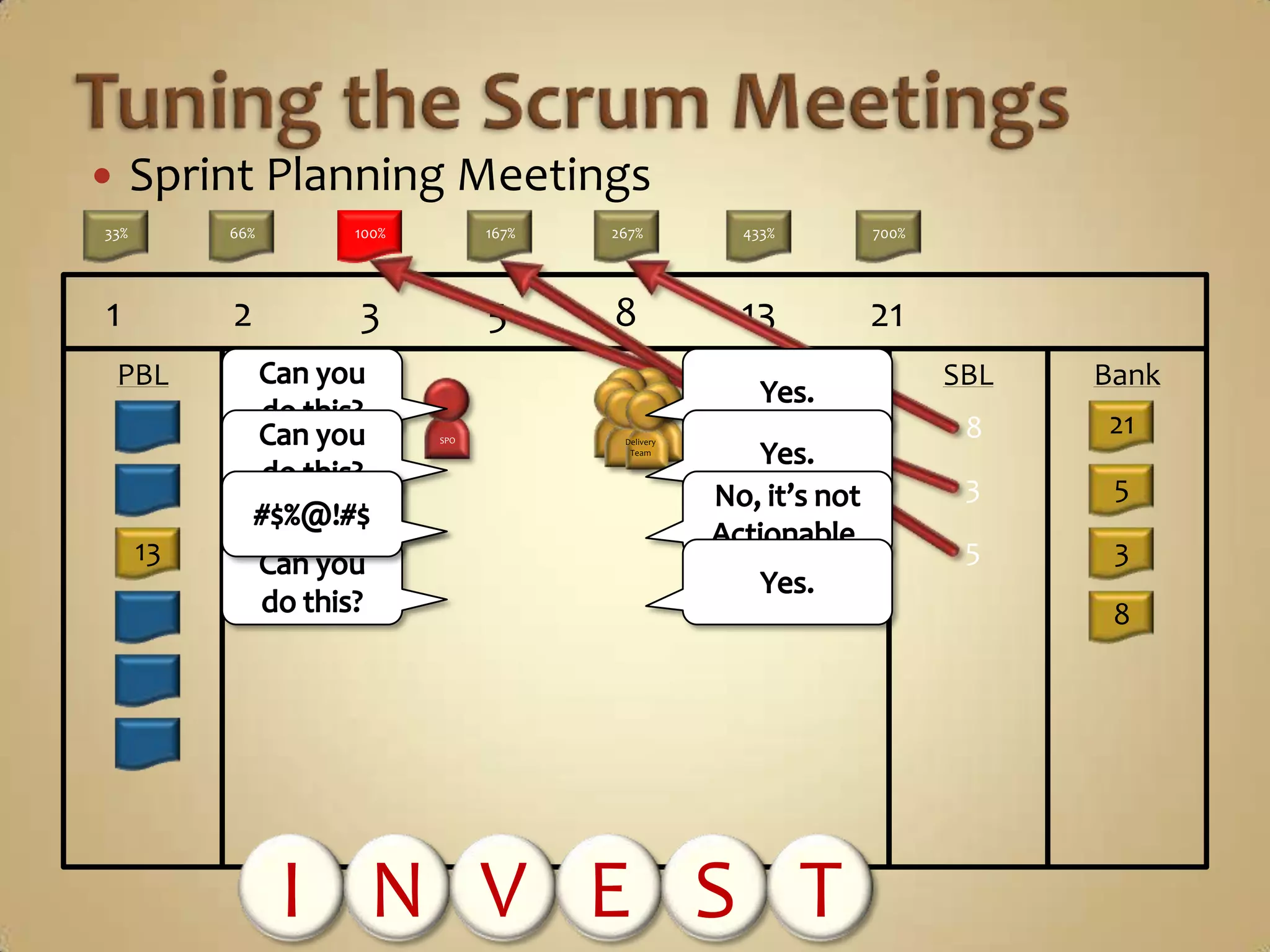

Sprint Planning MeetingsTuning the Scrum MeetingsPlanning MeetingTeam’sCommitmentAutomaticTaskingProduct Backlog
Sprint Planning MeetingsTuning the Scrum MeetingsPlanning MeetingSprint BacklogINVESTGoal: Accept the LARGESTchunk of work that passesthe INVEST mnemonic, thenstop digesting it and get it done.

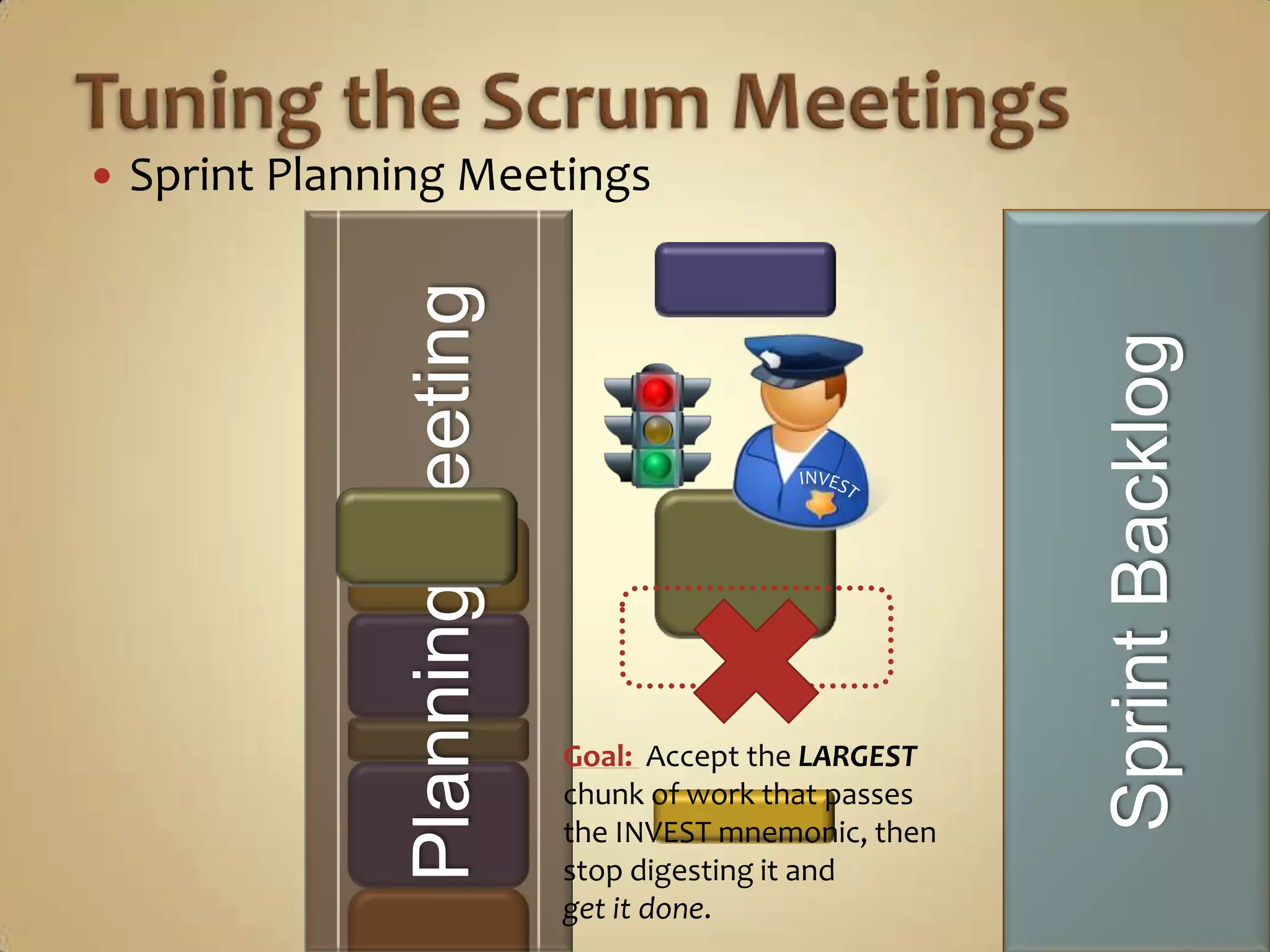

Technologists’PerspectiveFront End WorkValue, Voice and VisibilityOur Amazing ProductAPI WorkDatabase Work

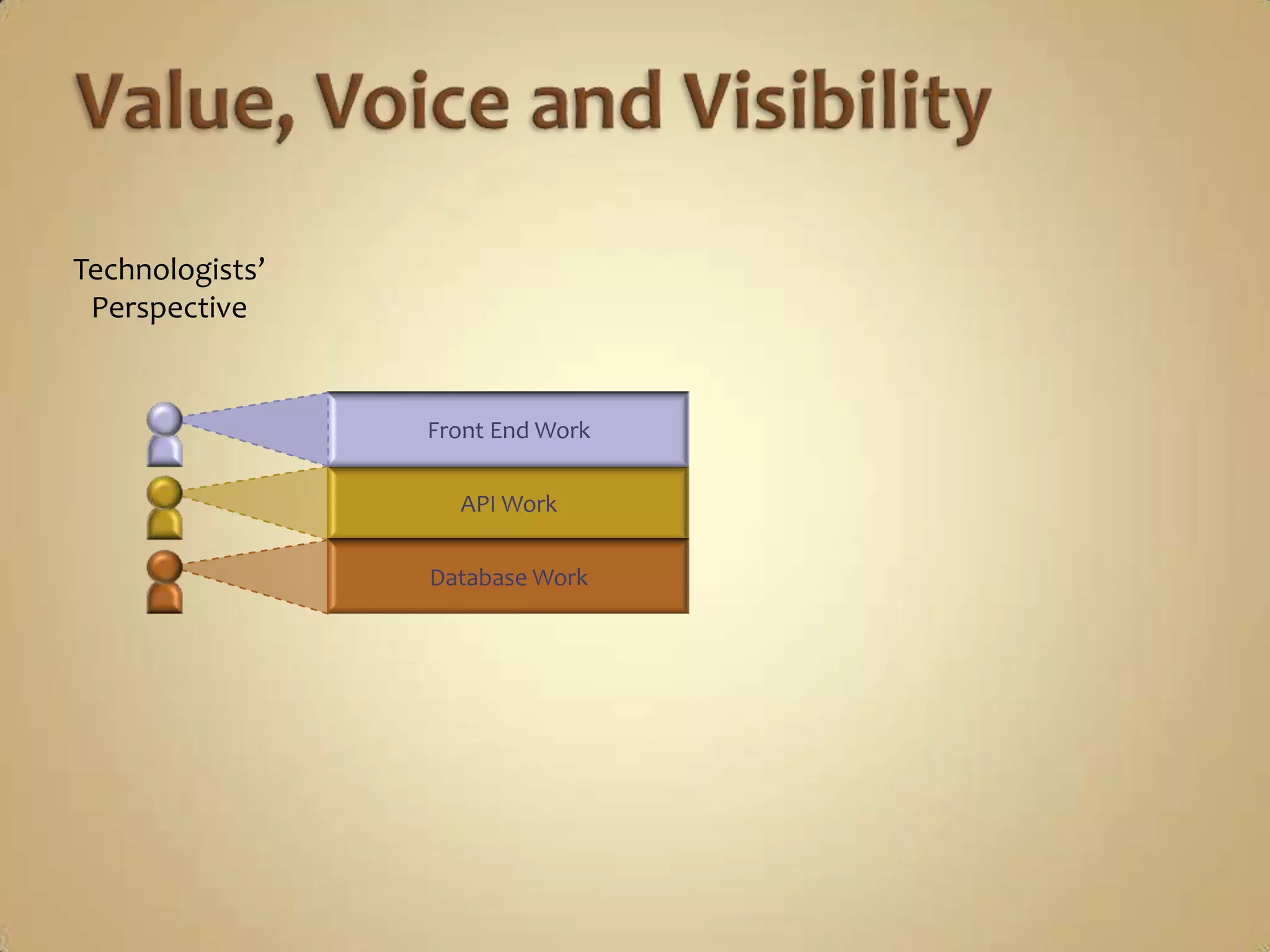

Customer’s PerspectiveFront End WorkAPI WorkFeature 2Value, Voice and VisibilityDatabase WorkFeature 1Feature 3

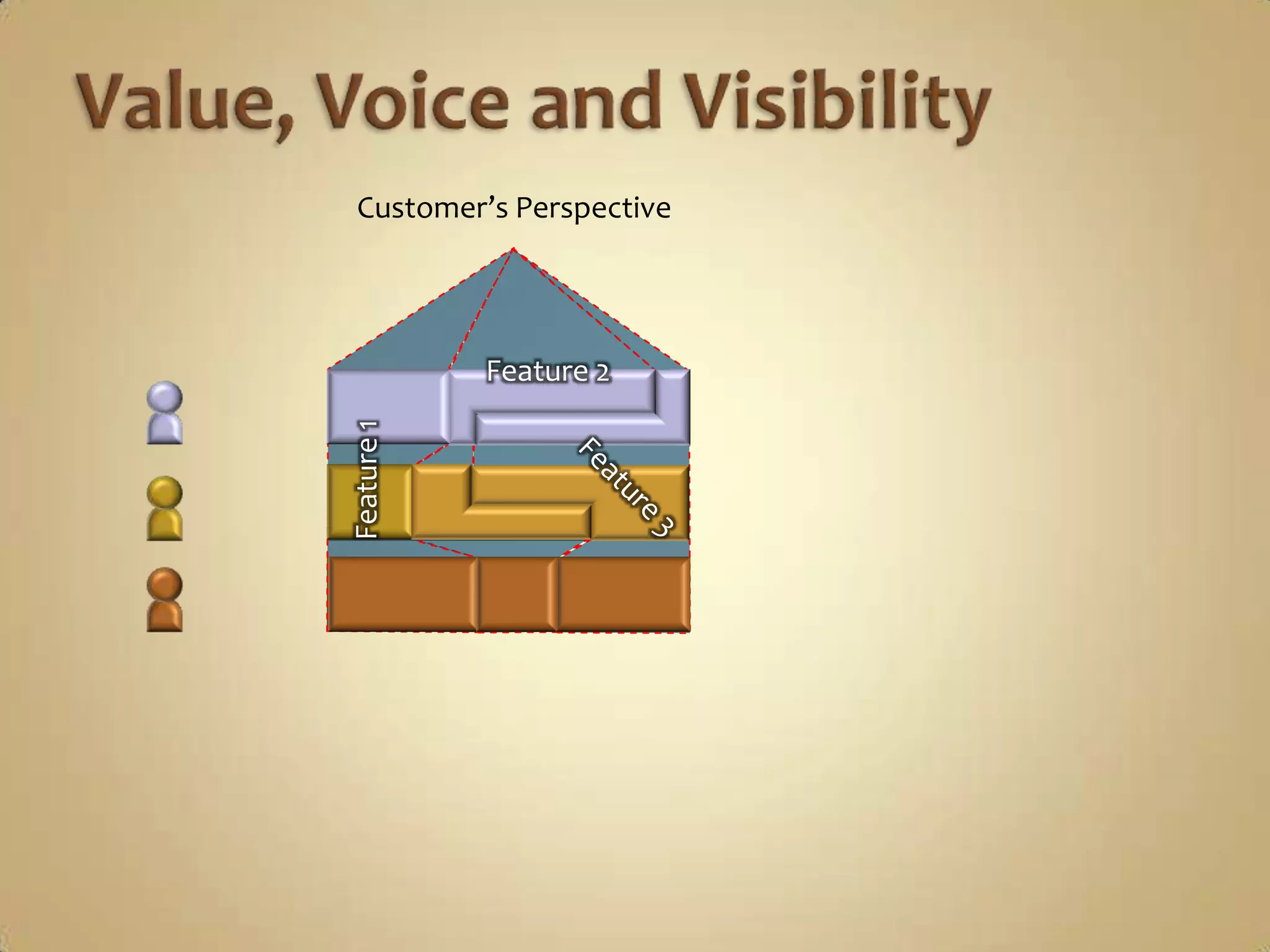

Value, Voice and Visibility
Value, Voice and VisibilityUser Story 1User Story 2

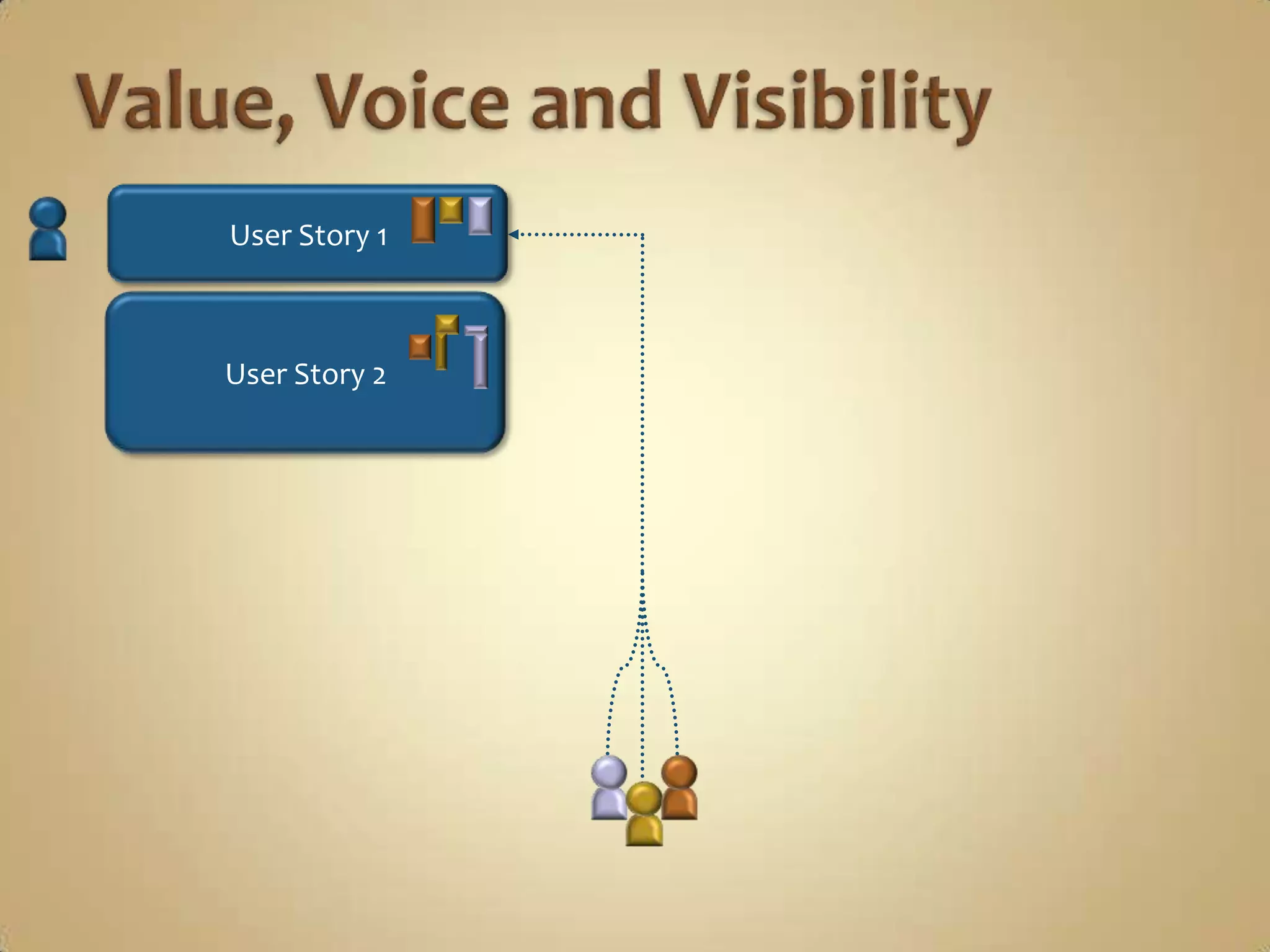

Value, Voice and VisibilityUser Story 1User Story 2
Value, Voice and VisibilityUser Story 1User Story 2
Customer’s PerspectiveUser Story 1User Story 2User Story 2.1Value, Voice and VisibilityUser Story 2.2
User Story 1User Story 2.1Value, Voice and VisibilityUser Story 2.2
Value, Voice and VisibilityUser Story 1User Story 2.1User Story 2.2Product BacklogSprint Backlog
The Fourth QuestionInformation RadiatorSPOSM
The Fourth QuestionInformation RadiatorSPO3SM
The Fourth QuestionWhat did WE Achieve Yesterday on Priority 1?What did you Achieve Yesterday on Priority 1?What will you Achieve Today on Priority 1?Is anything blocking or jeopardizing your progress on Priority 1?Information RadiatorWhat will WEAchieve Today on Priority 1?Is anything blocking or jeopardizing OURprogress on Priority 1?What will WEAchieve Today on Priority 1?Is anything blocking or jeopardizing OURprogress on Priority 1?Compared to our Keystone, how many Story Points did WE Achieve yesterday on Priority 1?SPO3SM
MetricsThe Math and Purpose of Each
MetricsThe Math and Purpose of Each

MetricsVelocityWork CapacityFocus FactorAdopted WorkFound WorkTargeted Value IncreaseAccuracy of EstimationAccuracy of Commit1:11:1
Metrics:  VelocityI, as a…  		Scrum Product Owner who is trying to create 			an accurate Roadmap for future releases

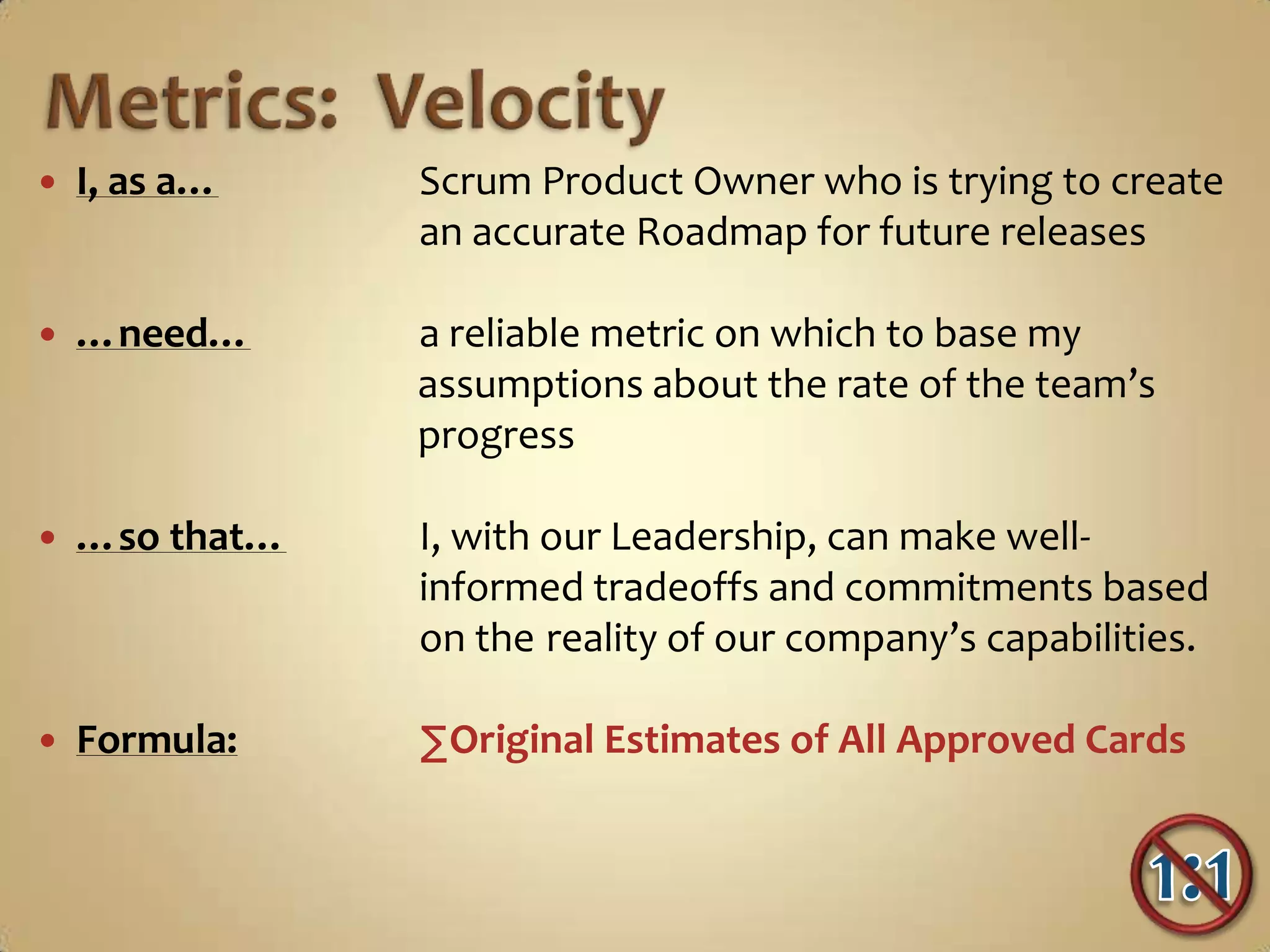

…need…		a reliable metric on which to base my                                          assumptions about the rate of the team’s                                          progress
…so that…		I, with our Leadership, can make well-			informed tradeoffs and commitments based 			on the 	reality of our company’s capabilities.
Formula: 	∑Original Estimates of All Approved Cards1:1
Metrics:  VelocityOriginal Estimate:    8 Story Points3SPO8EstimatePriority 25Original Estimate:    3 Story PointsPriority 33Velocity =8Priority 1Original Estimate:    5 Story Points511

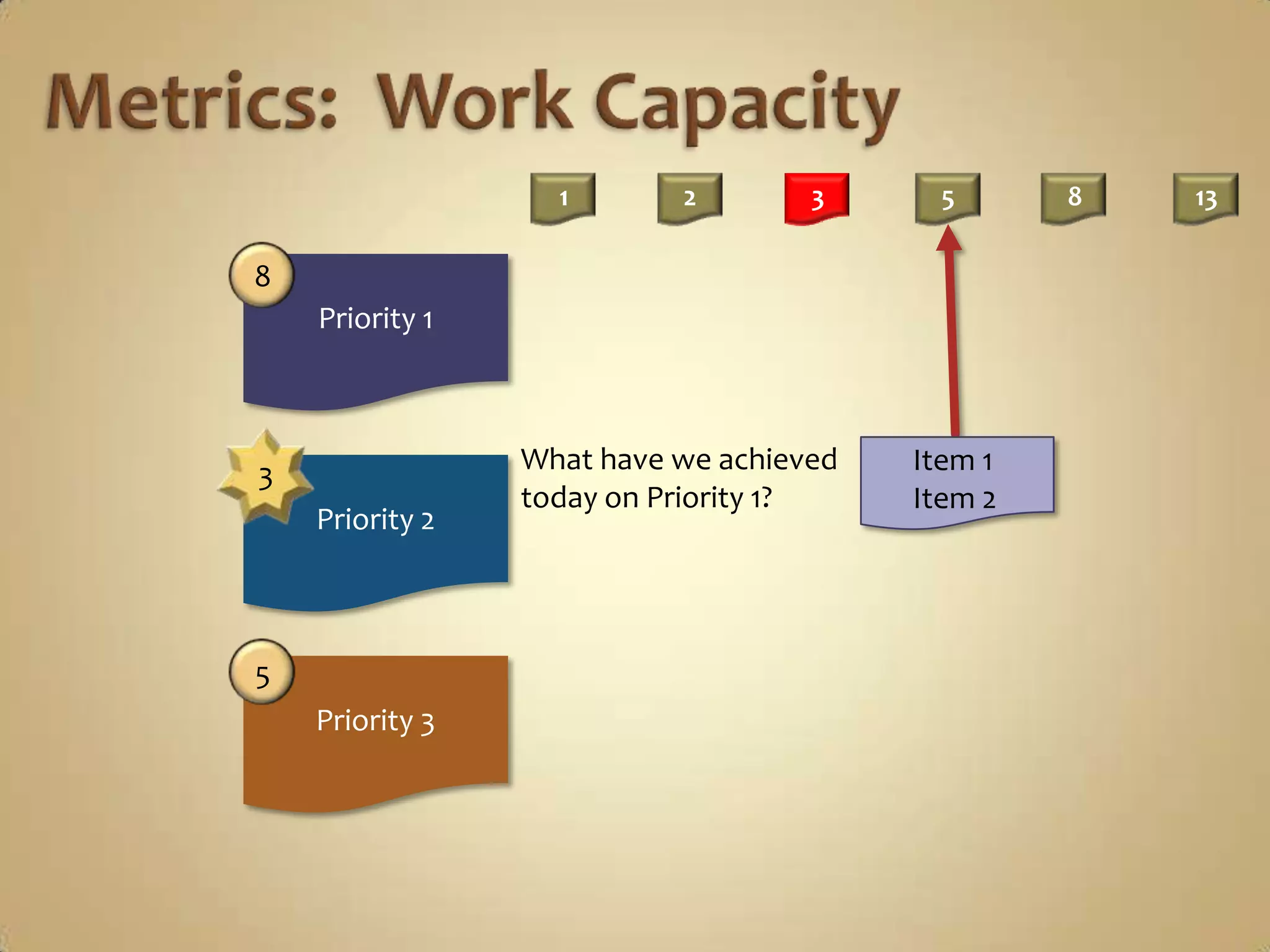

Metrics:  Work CapacityI, as a…  		Scrum Master who is trying to coach a Team 			toward Hyper-Productivity

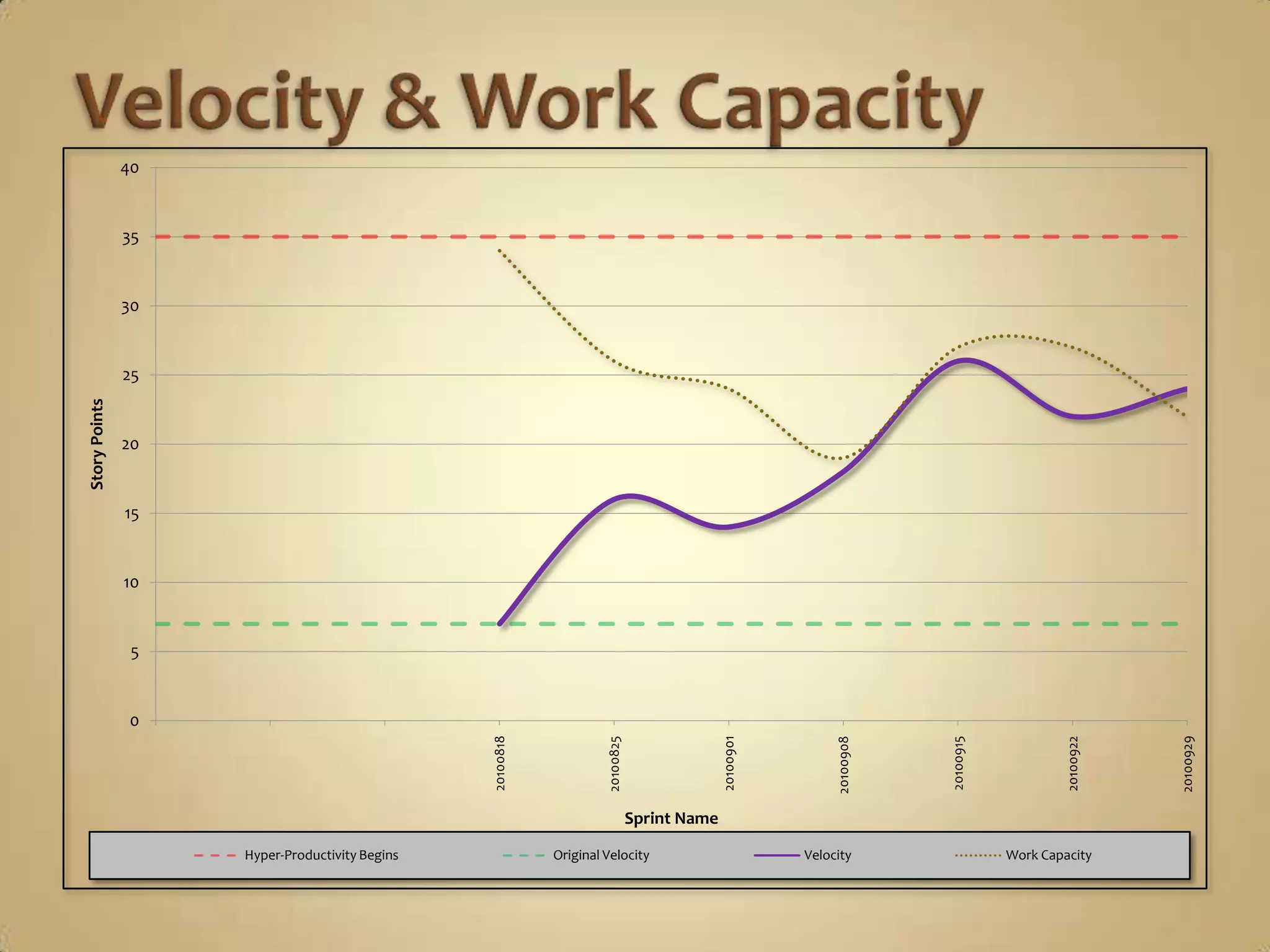

…need…		a way to measure how much work the Team 			can do in a given Sprint, whether it 			results in an Approved Card or not,
…so that…		I can quantify the Team’s entire capability, ask 			intelligent questions about distractions and 			take action to optimize the conversion of Effort into Value.
Formula: 	∑All Work Reported During the Sprint1:1
Metrics:  Work Capacity32158133Priority 25Priority 3What have we achieved today on Priority 1?Item 1Item 28Priority 1
Metrics:  Work Capacity33SPOOriginal Estimate:    8 Story Points8EstimatePriority 2Priority 28Work Reported   :     8 Story PointsReportedWorkCapacity=55Priority 3Priority 3Velocity=Original Estimate:    3 Story Points3Work Reported:        2 Story Points28Priority 1Original Estimate:    5 Story Points5Work Reported   :     7 Story Points71117

Velocity & Work Capacity

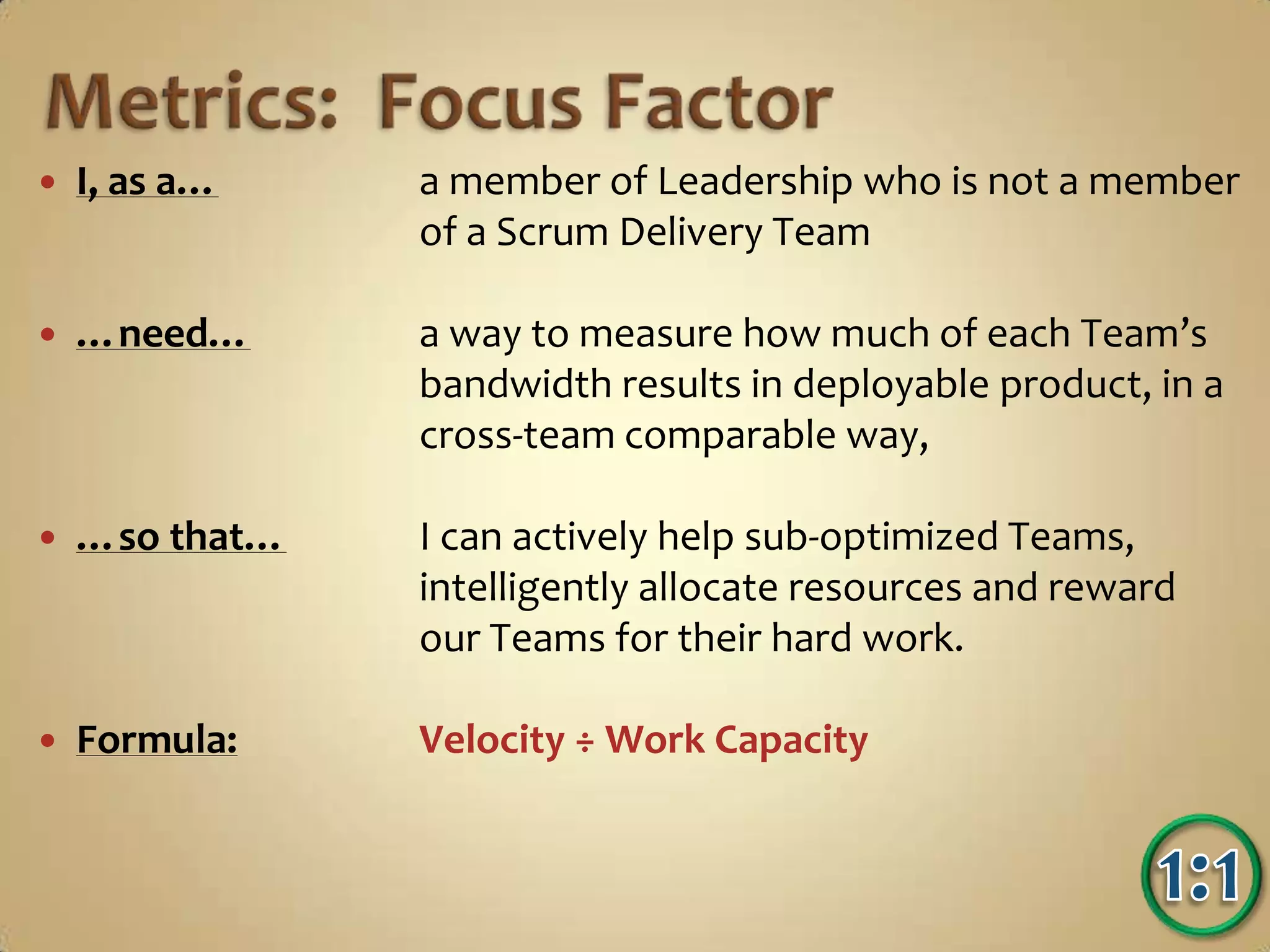

Metrics:  Focus FactorI, as a…  		a member of Leadership who is not a member 			of a Scrum Delivery Team
…need…		a way to measure how much of each Team’s			bandwidth results in deployable product, in a 			cross-team comparable way,
…so that…		I can actively help sub-optimized Teams, 			intelligently allocate resources and reward 			our Teams for their hard work.
Formula: 	Velocity ÷ Work Capacity1:1

Metrics:  Focus FactorAttempts to force non-deterministic systemsto operate at greater than80% efficiency will causeshort bursts of stabilizationfollowed by extreme periodsof destructive and unpredictable variationsfrom that goal.64.7%WorkCapacityVelocity1117W. Edwards Deming
Focus Factor
Metrics:  Adopted WorkI, as a…  	a Scrum Master, who is trying to coach a team 		toward more accurate Commitments during each Sprint Planning Meeting,
…need…	a metric that clearly shows if the Team has a 			tendency to under Commit and is consistently having 		to pull work forward from the Product Backlog 		before the end of the Sprint
…so that…	I can encourage the Team toward higher 		Commitments during the Sprint Planning Meetings 		without the risk of pushing them to failure.
Formula: ∑Original Estimates for Work Pulled Forward				Original Commitment1:1
Metrics:  Adopted WorkOriginal Commitment:0349111919PBLSBLIn ProgDONEAdopted Work:000000133Total Commitment:034911193215Adopted Work = 13 ÷ 19 = 68.4%INVEST28135Sprint-O-Meter8Day 3Day 23Day 4Day 5Day 15

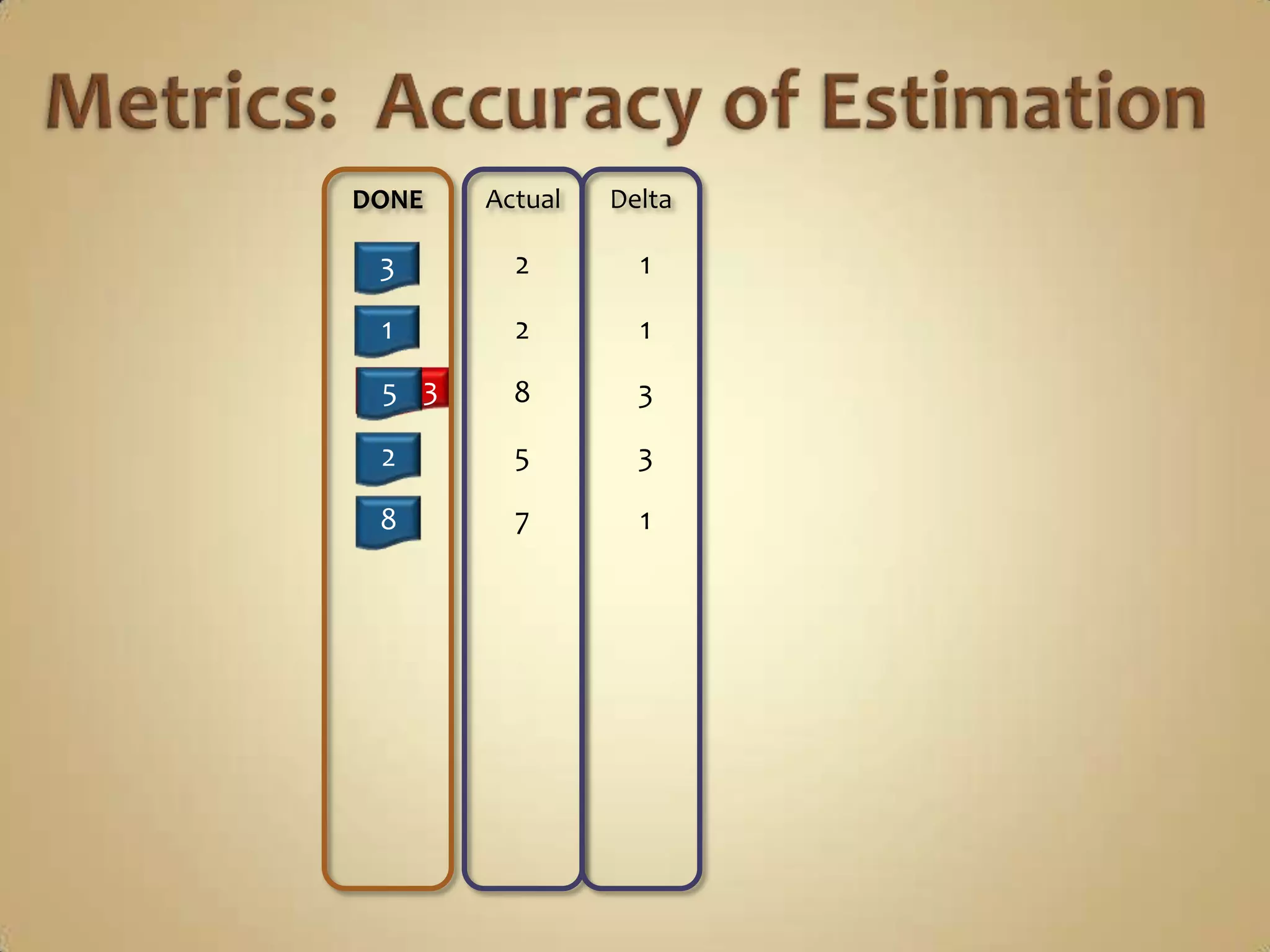

Metrics:  Adopted WorkSprint-O-MeterDay 3Day 2Day 4Day 5Day 1

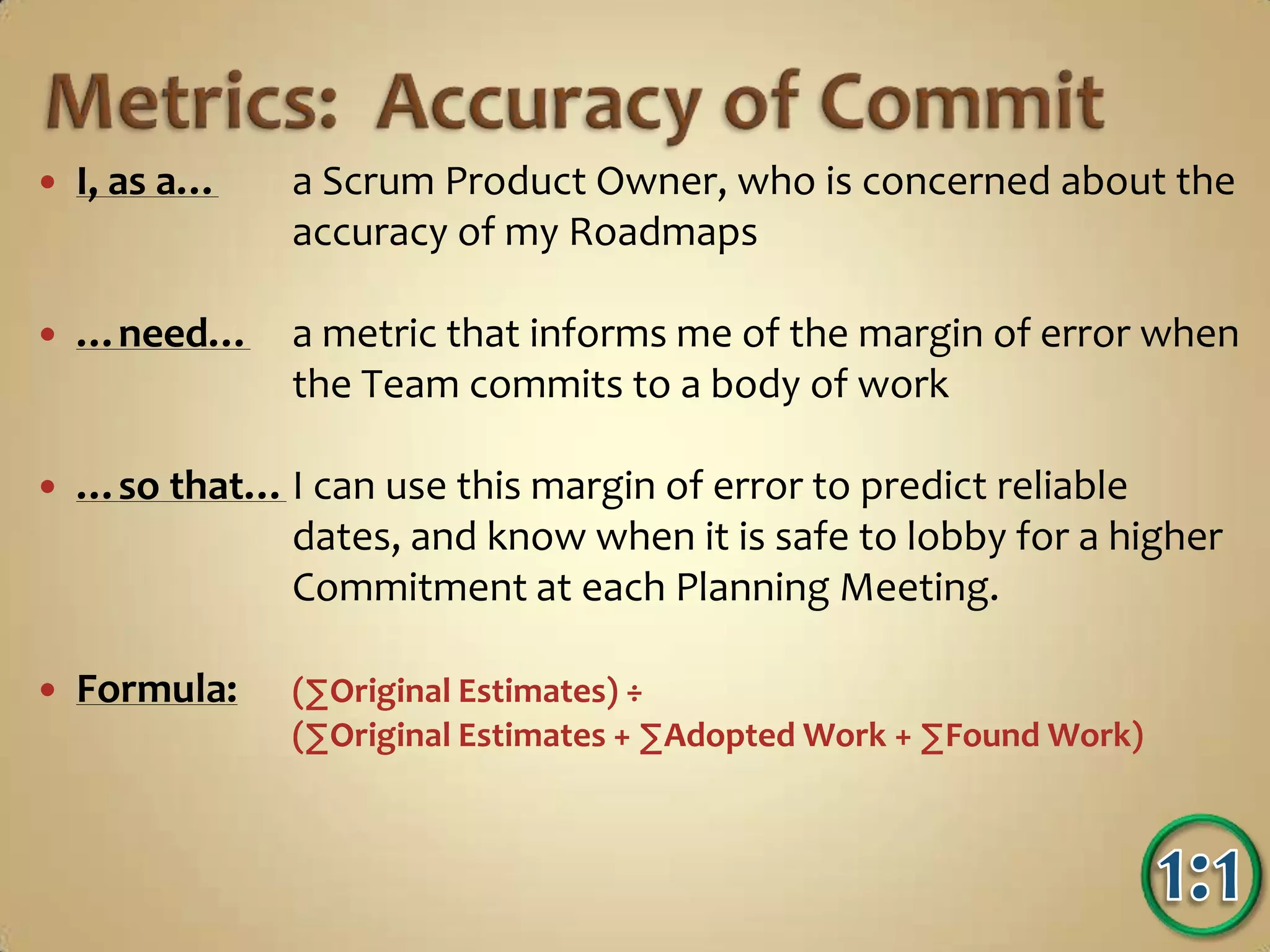

Metrics:  Found WorkI, as a…  	a Scrum Master, who is trying to help my Team make 		more accurate and reliable Commitments in Sprint 		Planning,
…need…	a clear way to measure the likelihood of unexpected 		work based on a Card’s Original Estimate
…so that…	I can offer advice to the Team on making achievable                            Commitments and provide them fair warning                             when they start to accept a Card that will probably 		surprise them.
Formula:∑Total Work Reported per Card – Original Estimate				   Original Commitment1:1

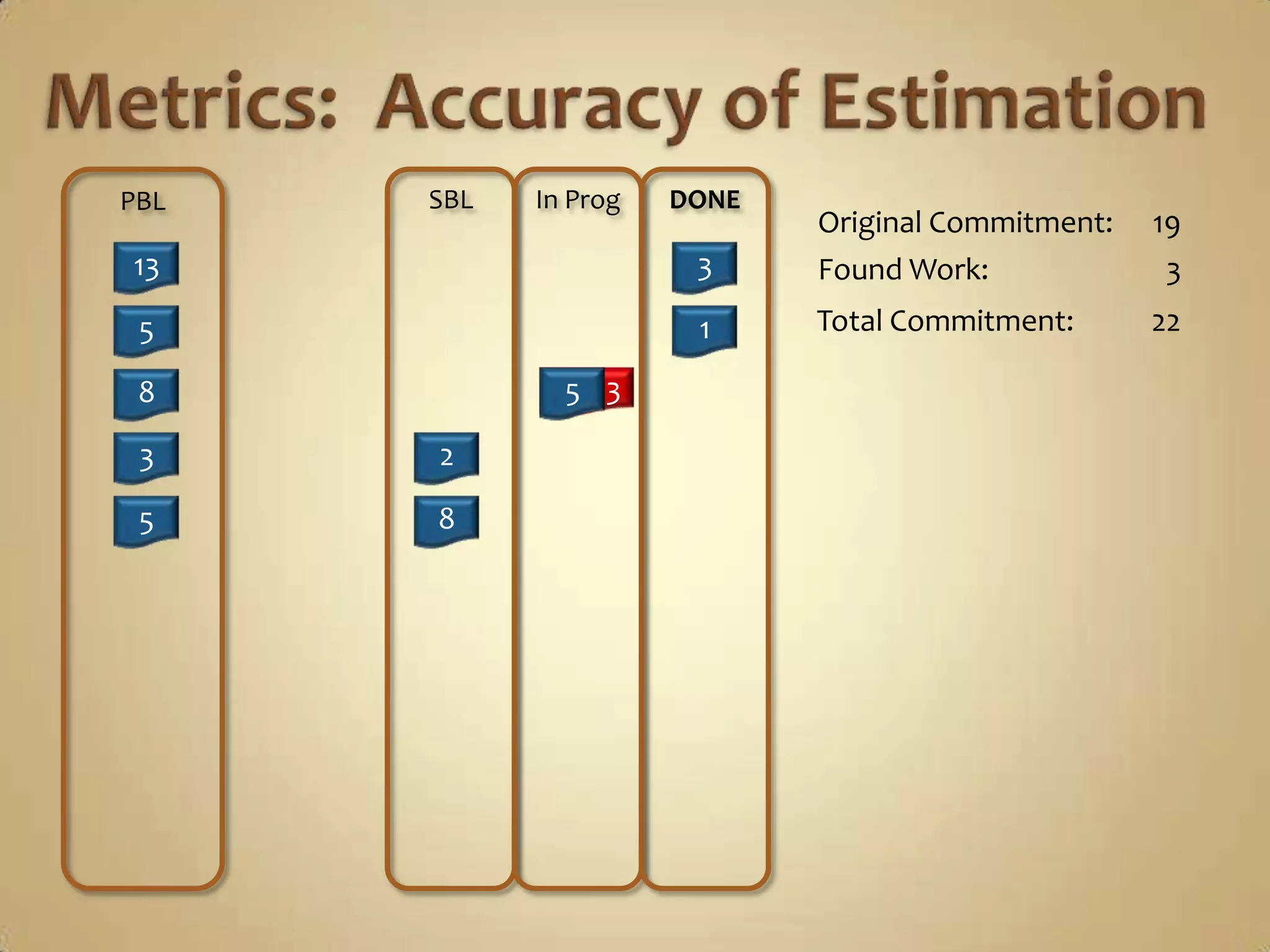

Metrics:  Found WorkPBLSBLIn ProgDONEOriginal Commitment:193Total Commitment:Total Commitment:19221Found Work:33528135835
Metrics:  Found + Adopted Work

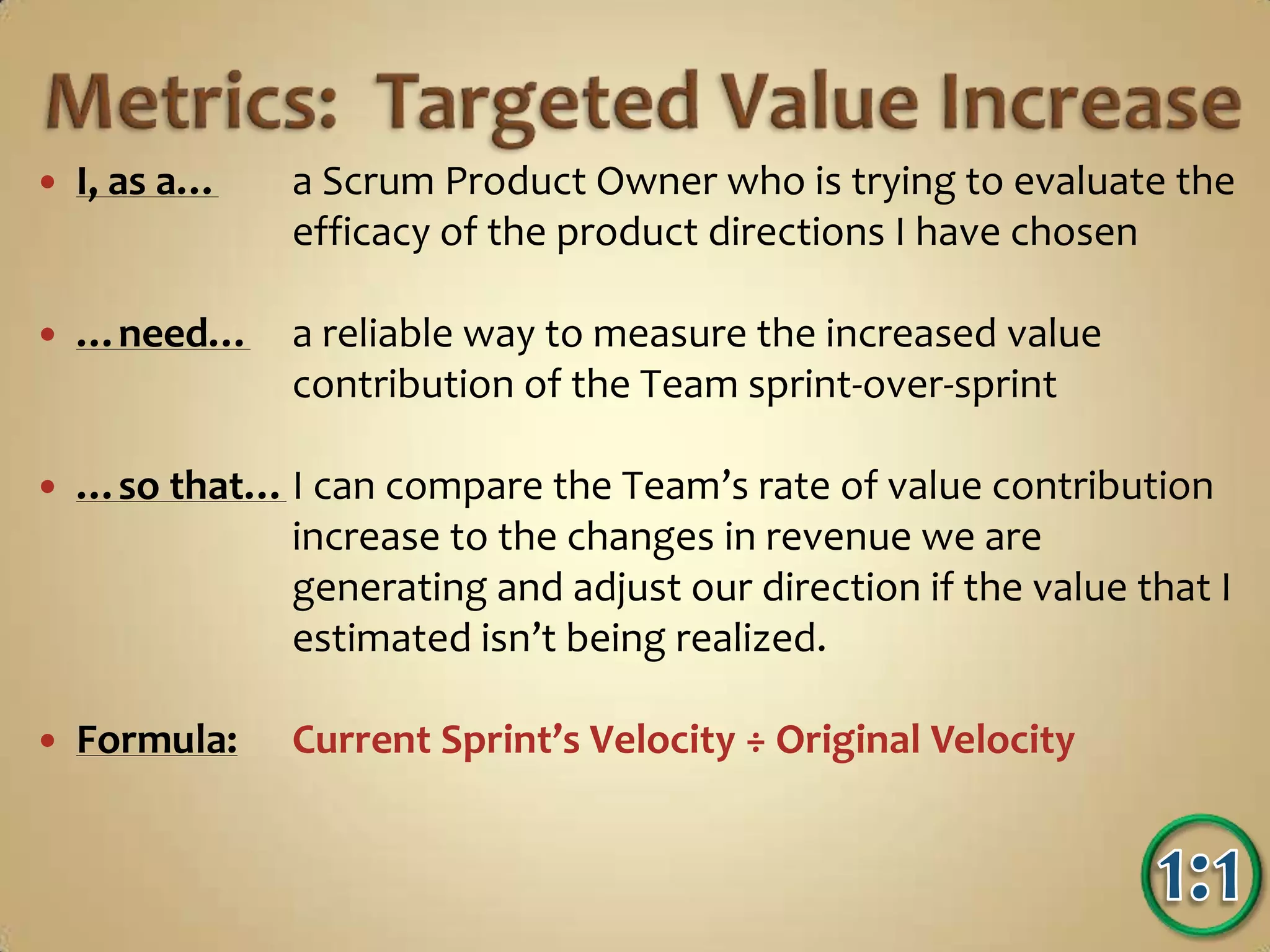

Metrics:  Targeted Value IncreaseI, as a…  	a Scrum Product Owner who is trying to evaluate the 		efficacy of the product directions I have chosen
…need…	a reliable way to measure the increased value 		contribution of the Team sprint-over-sprint

Measuring Scrum

  • 1.
    Scrum Metrics forHyper-Productive Teams: How They Fly like Fighter AircraftBy Jeff Sutherland and Scott Downey
  • 2.

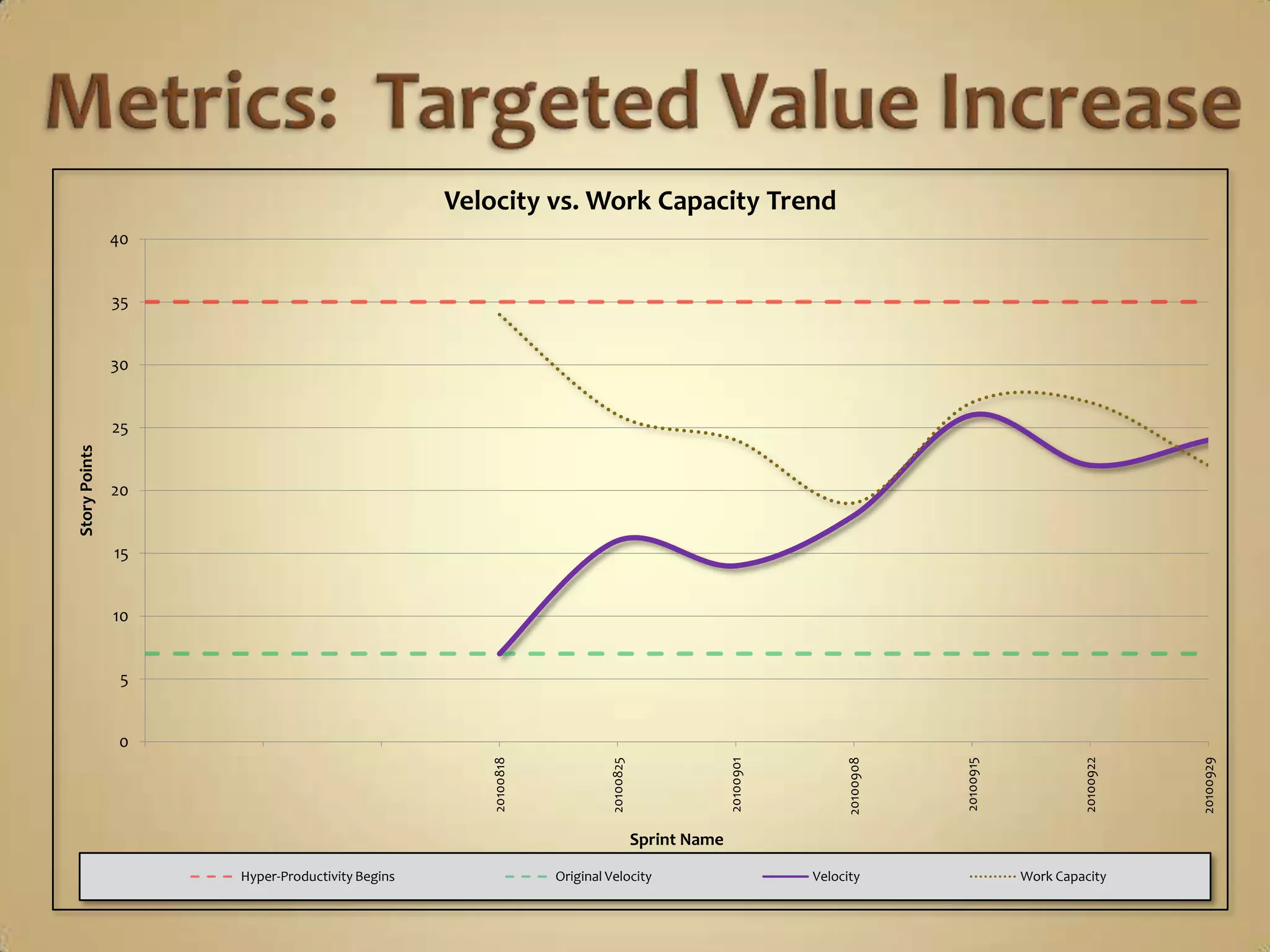

    Scrum Metrics forHyper-Productive Teams: How They Fly like Fighter AircraftBy Jeff Sutherland and Scott Downey
  • 3.
    What’s AheadGoalTuning theScrum MeetingsMetrics: Math and PurposeThe RoboScrum Workbook
  • 4.
    What’s AheadGoalTuning theScrum MeetingsMetrics: Math and PurposeThe RoboScrum Workbook
  • 5.
    Jeff SutherlandChairman, ScrumTraining InstituteCEO Scrum, Inc. & Sr. Advisor toOpenView Venture PartnersAgile Coach for OpenView Venture Partners portfolio companiesCEO/CTO/VPE for 11 Software CompaniesCreated first Scrum at Easel Corp. in 1993Rolled out Scrum in the next 7 CompaniesAchieved Hyper-Productive State in All Companies.Signatory of the Agile ManifestoFounder of the Agile Alliancehttp://www.JeffSutherland.comJeff@ScrumInc.com
  • 6.
    Jeff SutherlandChairman, ScrumTraining InstituteCEO Scrum, Inc. & Sr. Advisor toOpenView Venture PartnersAgile Coach for OpenView Venture Partners portfolio companiesCEO/CTO/VPE for 11 Software CompaniesCreated first Scrum at Easel Corp. in 1993Rolled out Scrum in the next 7 CompaniesAchieved Hyper-Productive State in All Companies.Signatory of the Agile ManifestoFounder of the Agile Alliancehttp://www.JeffSutherland.comJeff@ScrumInc.com
  • 7.

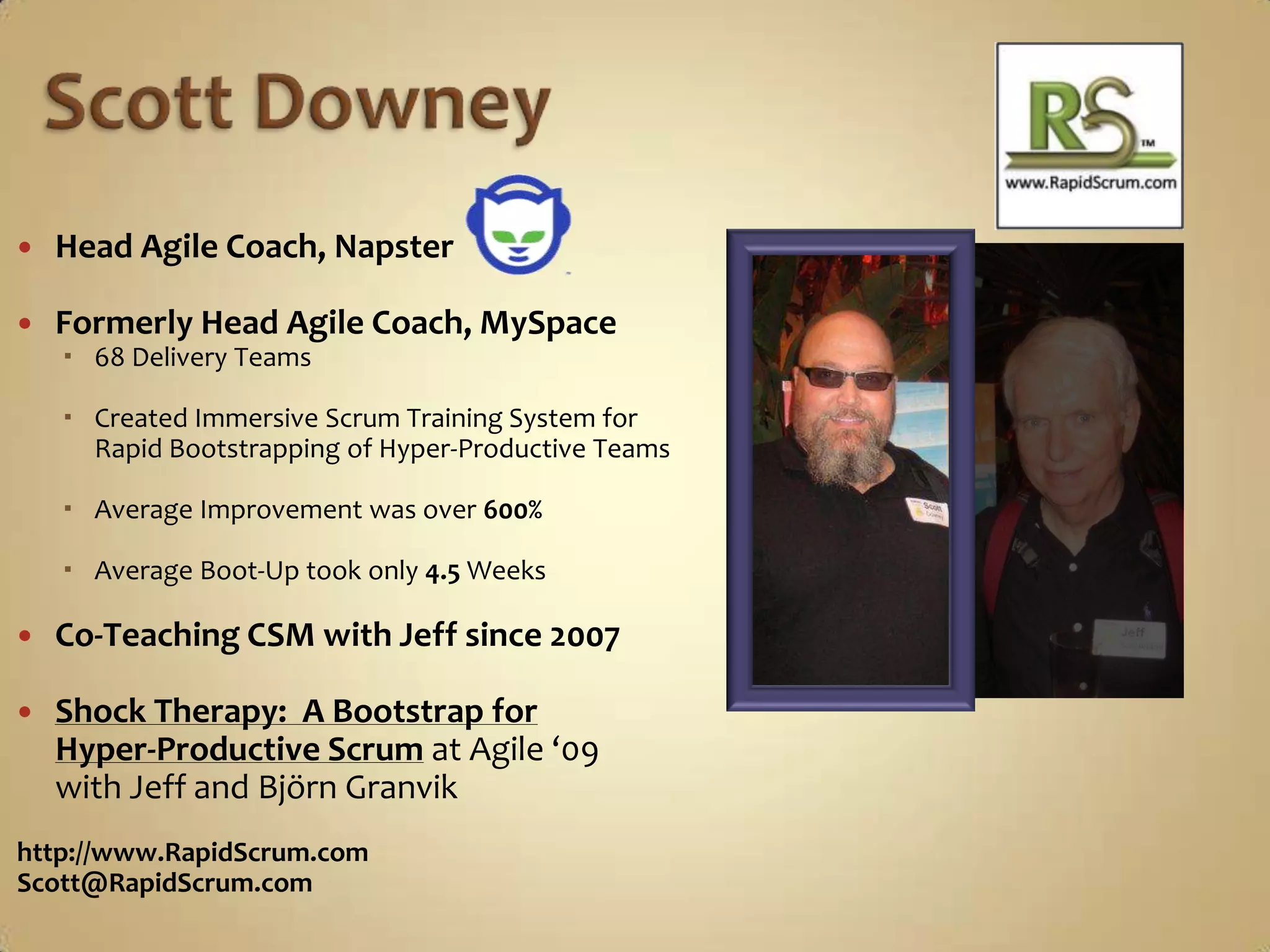

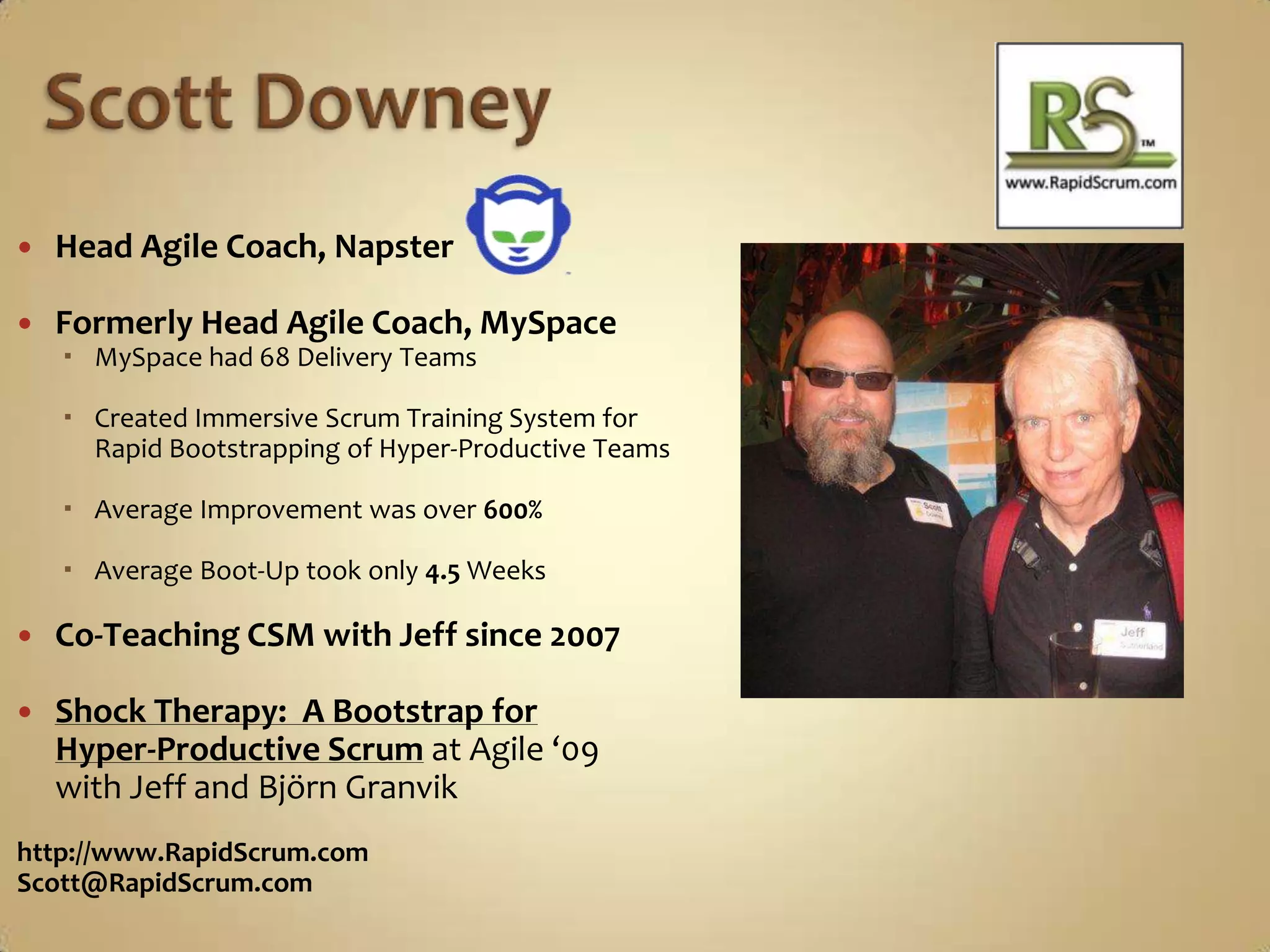

    Scott DowneyHead AgileCoach, NapsterFormerly Head Agile Coach, MySpace68 Delivery TeamsCreated Immersive Scrum Training System for Rapid Bootstrapping of Hyper-Productive TeamsAverage Improvement was over 600%Average Boot-Up took only 4.5 WeeksCo-Teaching CSM with Jeff since 2007Shock Therapy: A Bootstrap for Hyper-Productive Scrumat Agile ‘09 with Jeff and Björn Granvikhttp://www.RapidScrum.comScott@RapidScrum.com
  • 8.
    Scott DowneyHead AgileCoach, NapsterFormerly Head Agile Coach, MySpaceMySpace had 68 Delivery TeamsCreated Immersive Scrum Training System for Rapid Bootstrapping of Hyper-Productive TeamsAverage Improvement was over 600%Average Boot-Up took only 4.5 WeeksCo-Teaching CSM with Jeff since 2007Shock Therapy: A Bootstrap for Hyper-Productive Scrumat Agile ‘09 with Jeff and BjörnGranvikhttp://www.RapidScrum.comScott@RapidScrum.com
  • 9.
    GoalTo develop andstandardize a set of Minimally-InvasiveMetricsthat will help Scrum Masters Evaluate and AdviseTeamswhile providing Rich Insights about Team performanceand a Fully PortableLanguage for team comparison across an Enterprise.
  • 10.
    INVEST Mnemonic RefresherImmediatelyActionableNegotiableValuableEstimableSized to FitTestableThanks to Bill Wake for the acronym. See www.xp123.com.
  • 11.
    Tuning the ScrumMeetingsCreating a Culture of Hyper-Productivity
  • 12.
    Tuning the ScrumMeetingsCreating a Culture of Hyper-Productivity
  • 13.
    Tuning the ScrumMeetingsSprint Planning MeetingsAnchoring the ScaleA New Perspective on INVESTValue, Voice and VisibilityDaily Stand-Up MeetingsThe Fourth Question
  • 14.
    Tuning the ScrumMeetingsSprint Planning MeetingsAnchoring the ScaleA New Perspective on INVESTValue, Voice and VisibilityDaily Stand-Up MeetingsThe Fourth QuestionSprint Planning MeetingsSprint Planning MeetingsKeystone: A central cohesive source of support and stability;The architectural piece that locks other pieces into position; That which provides structural integrity.Tuning the Scrum Meetings
  • 15.
    Sprint Planning MeetingsThat’sthe most important.Priority 1DeliveryTeamPriority 2Tuning the Scrum MeetingsPriority 3SPO
  • 16.
    Tuning the ScrumMeetingsThat’s the easiest.Sprint Planning MeetingsPriority 1DeliveryTeamPriority 2Priority 3SPODeliveryTeam
  • 17.

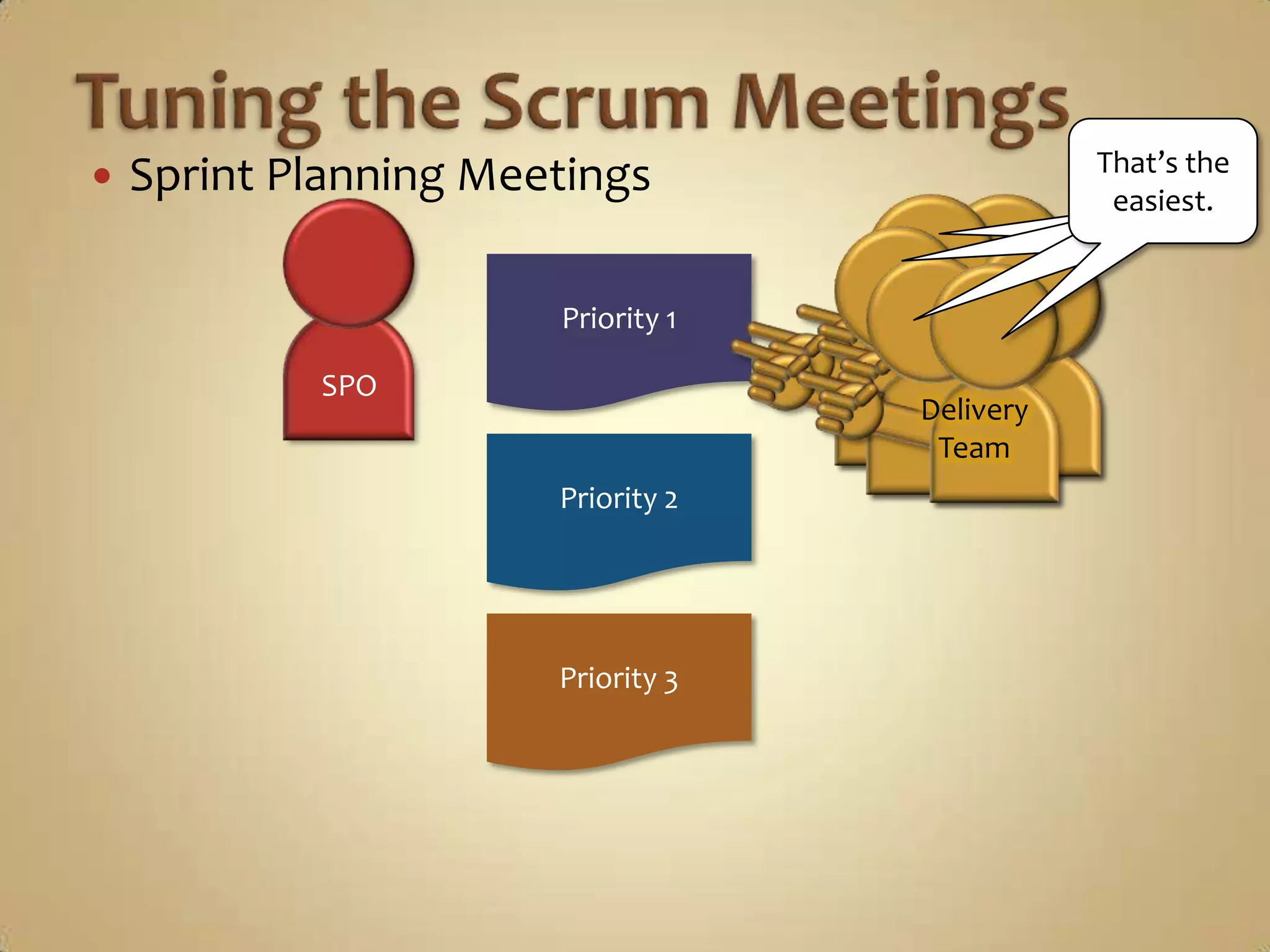

    Sprint Planning MeetingsTuningthe Scrum MeetingsThat’s a 3.Priority 23DeliveryTeamPriority 3Scrum MasterPriority 1SPO
  • 18.

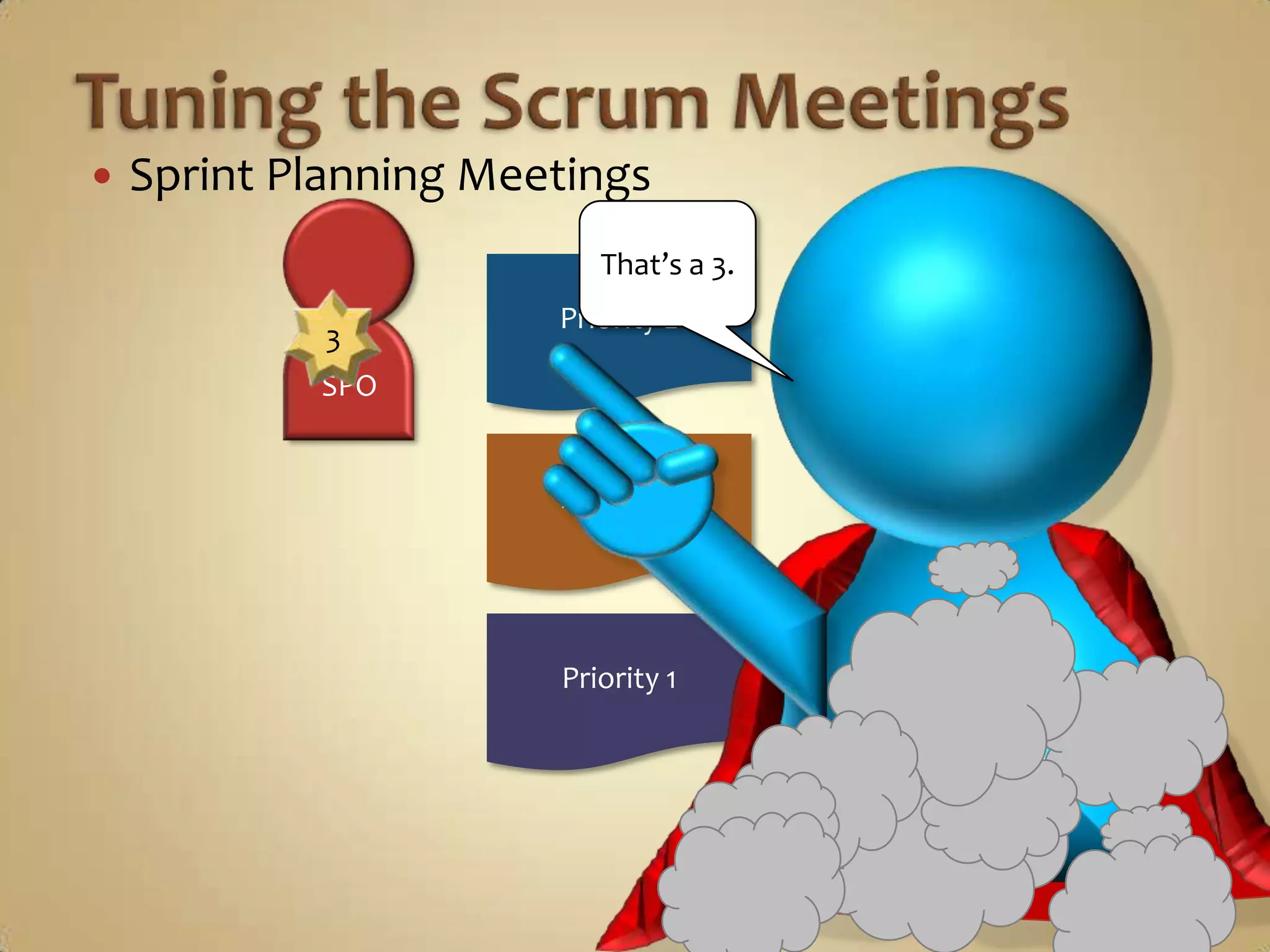

    Sprint Planning MeetingsTuningthe Scrum Meetings3Priority 2DeliveryTeamPriority 3SPOPriority 1
  • 19.
    Sprint Planning Meetings3Priority2DeliveryTeamTuning the Scrum Meetings58Priority 33Priority 1SPO
  • 20.
  • 21.
    Sprint Planning MeetingsTuningthe Scrum Meetings33%100%66%167%267%433%1 2 3 5 8 13
  • 22.

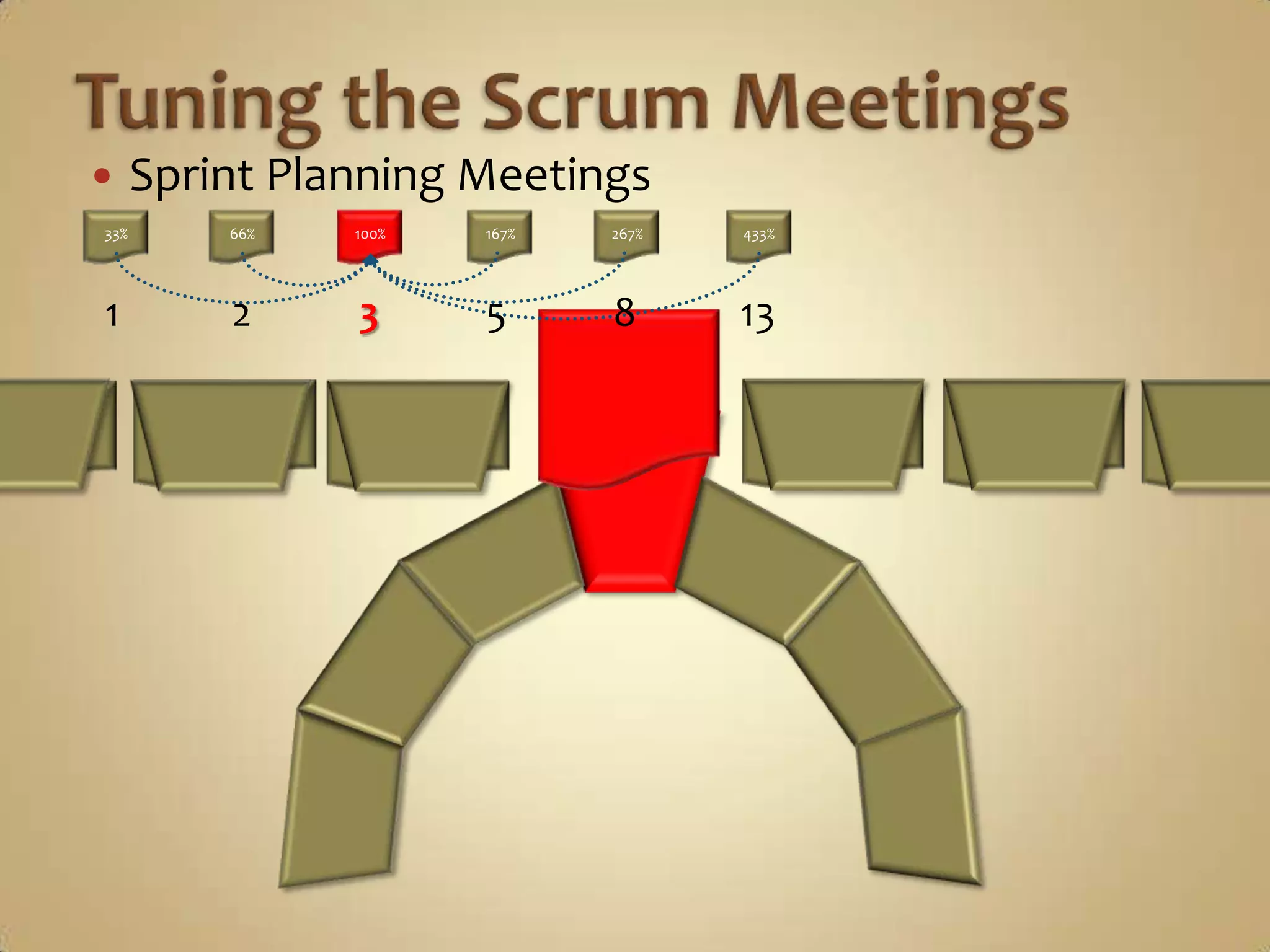

    Sprint Planning MeetingsTuningthe Scrum Meetings100%66%33%167%267%433%1 2 3 5 8 13 21 34 551 2 3 5 8 13 34 55PBLSBLBankDo you Approve?Yes.DeliveryTeam21Do you Approve?Yes.5!@#$%^&Do you Approve?No.13Do you Approve?Yes.3Do you Approve?Yes.SPO8
  • 23.
    Sprint Planning MeetingsTuningthe Scrum Meetings100%66%33%167%267%433%700%1 2 3 5 8 13 21 34 551 2 3 5 8 13 21 34 55PBLSBLBankYes.Can you do this?DeliveryTeam821Yes.Can you do this?35No, it’s not Actionable.Can you do this?#$%@!#$5133Yes.Can you do this?8SPOINVEST
  • 24.

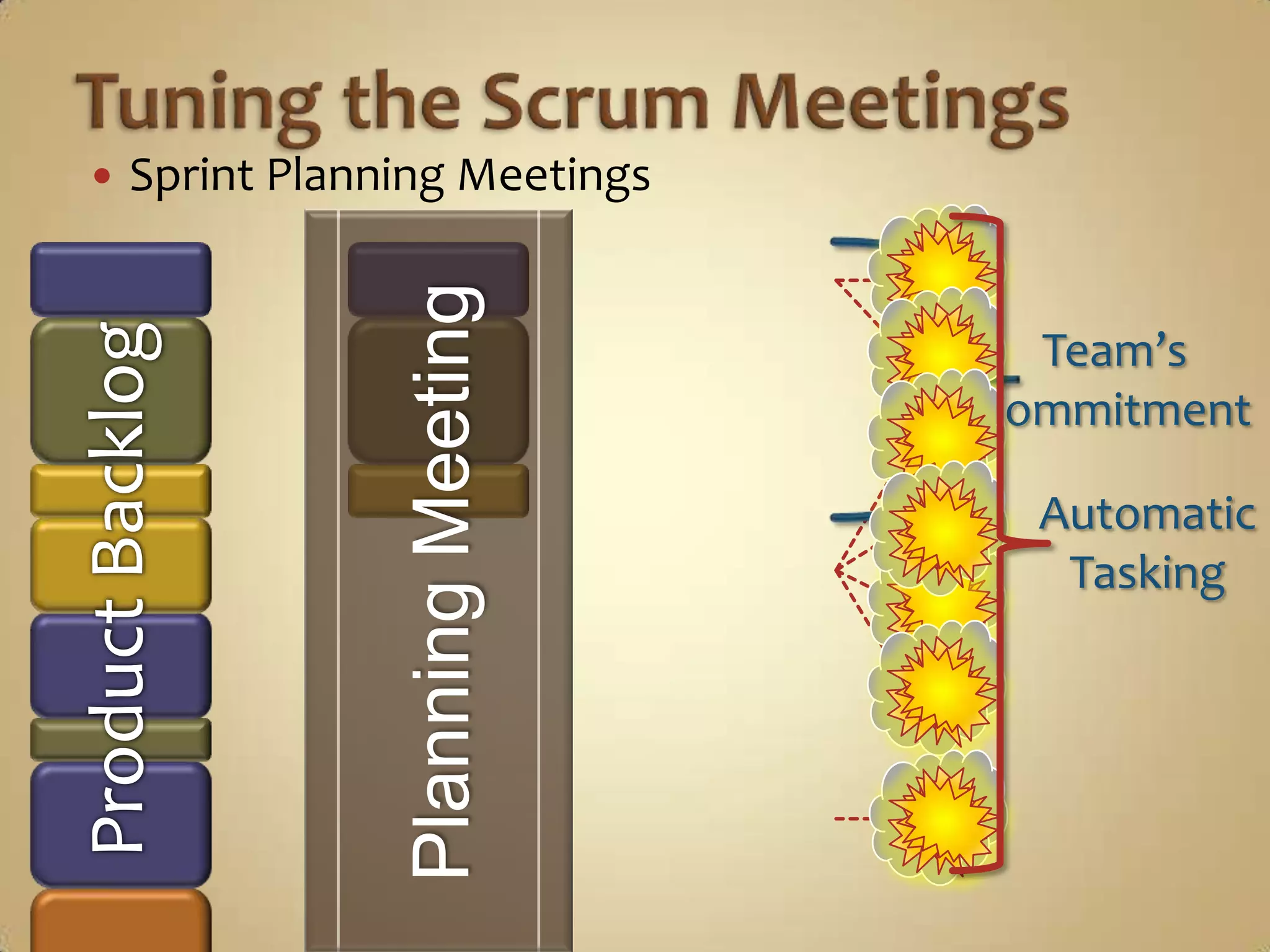

    Sprint Planning MeetingsTuningthe Scrum MeetingsPlanning MeetingTeam’sCommitmentAutomaticTaskingProduct Backlog
  • 25.
    Sprint Planning MeetingsTuningthe Scrum MeetingsPlanning MeetingSprint BacklogINVESTGoal: Accept the LARGESTchunk of work that passesthe INVEST mnemonic, thenstop digesting it and get it done.
  • 26.
    Technologists’PerspectiveFront End WorkValue,Voice and VisibilityOur Amazing ProductAPI WorkDatabase Work
  • 27.
    Customer’s PerspectiveFront EndWorkAPI WorkFeature 2Value, Voice and VisibilityDatabase WorkFeature 1Feature 3
  • 28.
  • 29.
    Value, Voice andVisibilityUser Story 1User Story 2
  • 30.
    Value, Voice andVisibilityUser Story 1User Story 2
  • 31.
    Value, Voice andVisibilityUser Story 1User Story 2
  • 32.
    Customer’s PerspectiveUser Story1User Story 2User Story 2.1Value, Voice and VisibilityUser Story 2.2
  • 33.
    User Story 1UserStory 2.1Value, Voice and VisibilityUser Story 2.2
  • 34.
    Value, Voice andVisibilityUser Story 1User Story 2.1User Story 2.2Product BacklogSprint Backlog
  • 35.
  • 36.
  • 37.
    The Fourth QuestionWhatdid WE Achieve Yesterday on Priority 1?What did you Achieve Yesterday on Priority 1?What will you Achieve Today on Priority 1?Is anything blocking or jeopardizing your progress on Priority 1?Information RadiatorWhat will WEAchieve Today on Priority 1?Is anything blocking or jeopardizing OURprogress on Priority 1?What will WEAchieve Today on Priority 1?Is anything blocking or jeopardizing OURprogress on Priority 1?Compared to our Keystone, how many Story Points did WE Achieve yesterday on Priority 1?SPO3SM
  • 38.
    MetricsThe Math andPurpose of Each
  • 39.
    MetricsThe Math andPurpose of Each
  • 40.
    MetricsVelocityWork CapacityFocus FactorAdoptedWorkFound WorkTargeted Value IncreaseAccuracy of EstimationAccuracy of Commit1:11:1
  • 41.
    Metrics: VelocityI,as a… Scrum Product Owner who is trying to create an accurate Roadmap for future releases
  • 42.
    …need… a reliable metricon which to base my assumptions about the rate of the team’s progress
  • 43.
    …so that… I, withour Leadership, can make well- informed tradeoffs and commitments based on the reality of our company’s capabilities.
  • 44.
    Formula: ∑Original Estimatesof All Approved Cards1:1
  • 45.
    Metrics: VelocityOriginalEstimate: 8 Story Points3SPO8EstimatePriority 25Original Estimate: 3 Story PointsPriority 33Velocity =8Priority 1Original Estimate: 5 Story Points511
  • 46.

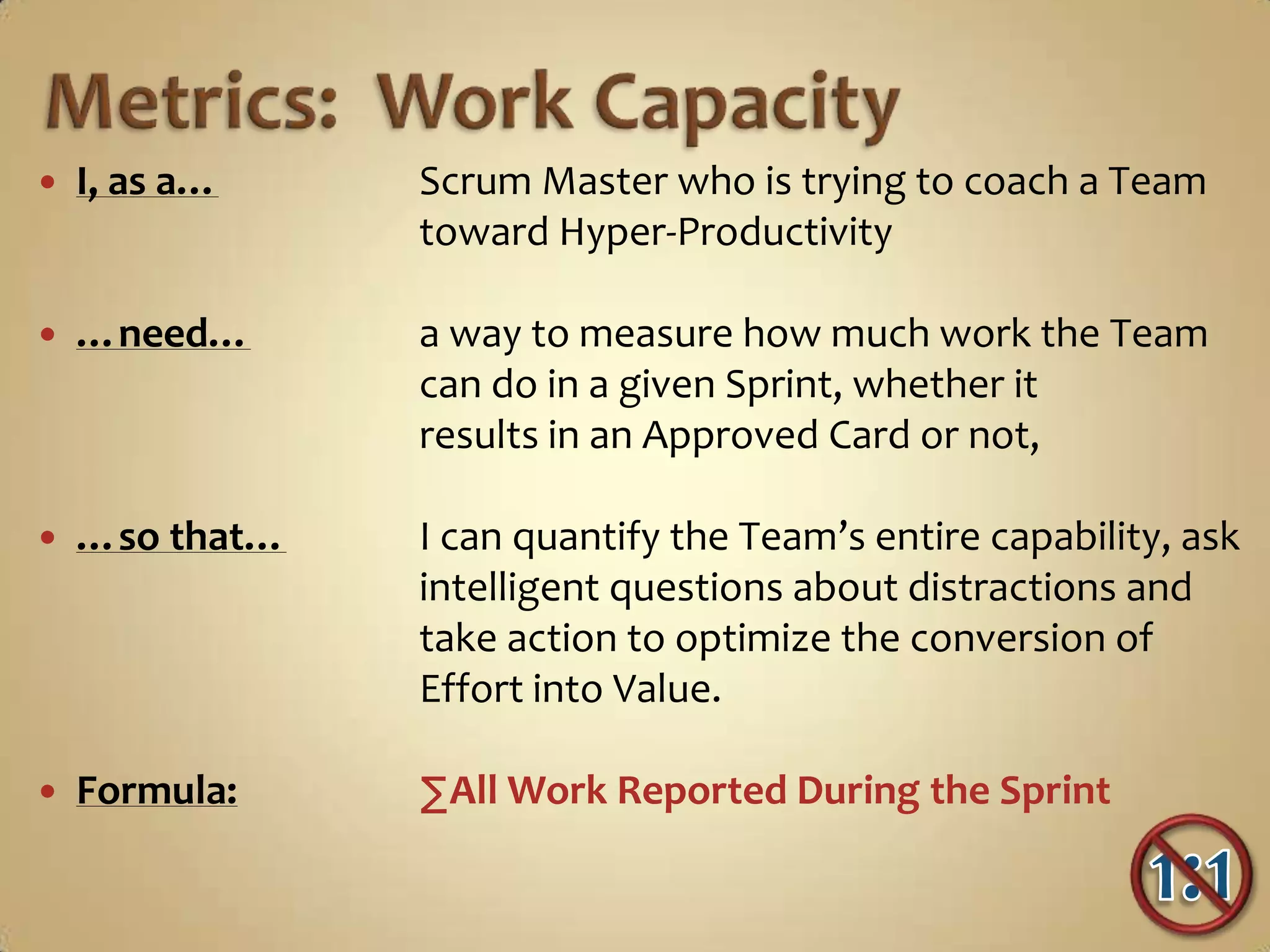

    Metrics: WorkCapacityI, as a… Scrum Master who is trying to coach a Team toward Hyper-Productivity
  • 47.
    …need… a way tomeasure how much work the Team can do in a given Sprint, whether it results in an Approved Card or not,
  • 48.
    …so that… I canquantify the Team’s entire capability, ask intelligent questions about distractions and take action to optimize the conversion of Effort into Value.
  • 49.
    Formula: ∑All WorkReported During the Sprint1:1
  • 50.
    Metrics: WorkCapacity32158133Priority 25Priority 3What have we achieved today on Priority 1?Item 1Item 28Priority 1
  • 51.
    Metrics: WorkCapacity33SPOOriginal Estimate: 8 Story Points8EstimatePriority 2Priority 28Work Reported : 8 Story PointsReportedWorkCapacity=55Priority 3Priority 3Velocity=Original Estimate: 3 Story Points3Work Reported: 2 Story Points28Priority 1Original Estimate: 5 Story Points5Work Reported : 7 Story Points71117
  • 52.
  • 53.
    Metrics: FocusFactorI, as a… a member of Leadership who is not a member of a Scrum Delivery Team
  • 54.
    …need… a way tomeasure how much of each Team’s bandwidth results in deployable product, in a cross-team comparable way,
  • 55.
    …so that… I canactively help sub-optimized Teams, intelligently allocate resources and reward our Teams for their hard work.
  • 56.
    Formula: Velocity ÷Work Capacity1:1
  • 57.

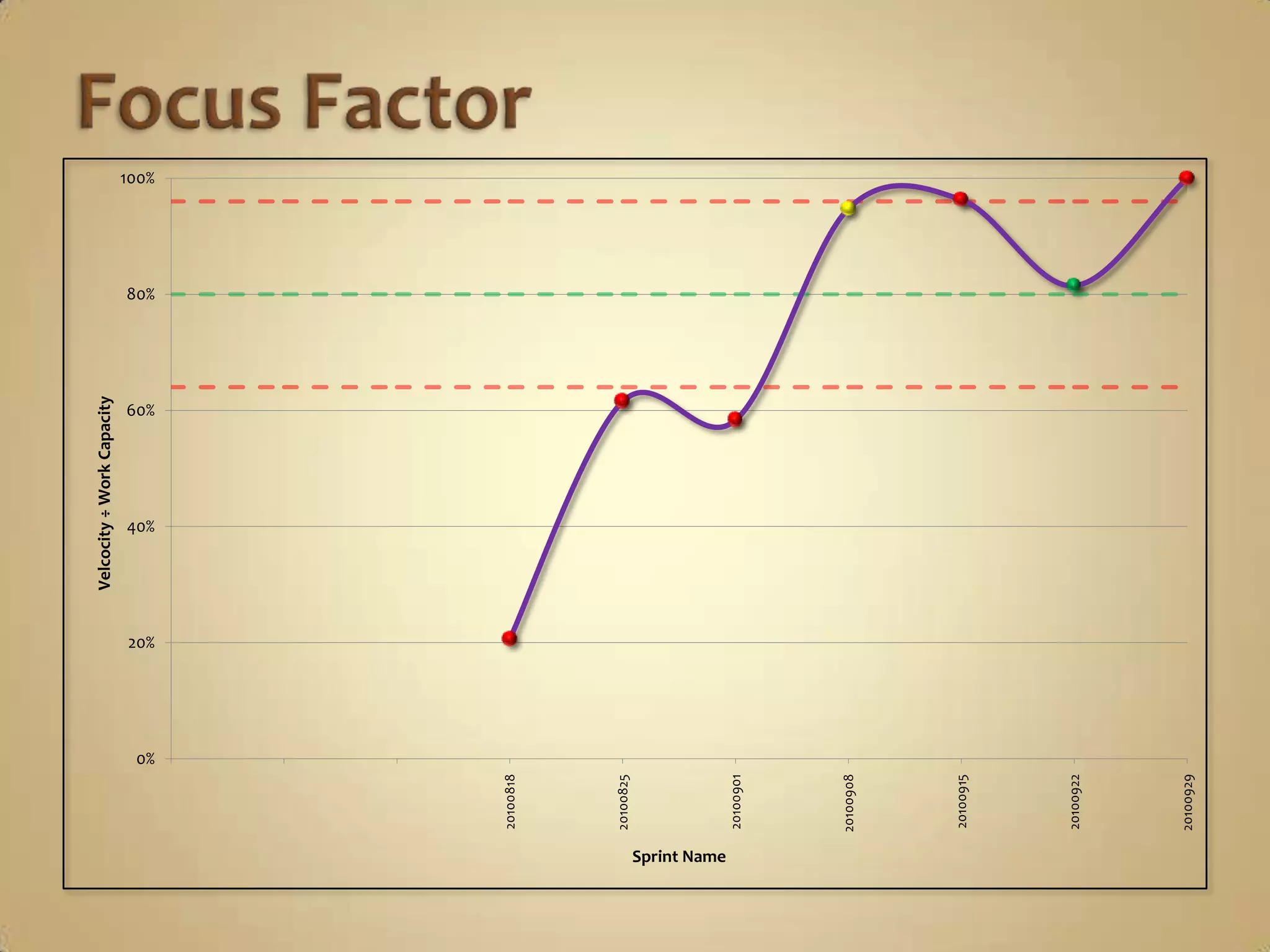

    Metrics: FocusFactorAttempts to force non-deterministic systemsto operate at greater than80% efficiency will causeshort bursts of stabilizationfollowed by extreme periodsof destructive and unpredictable variationsfrom that goal.64.7%WorkCapacityVelocity1117W. Edwards Deming
  • 58.
  • 59.

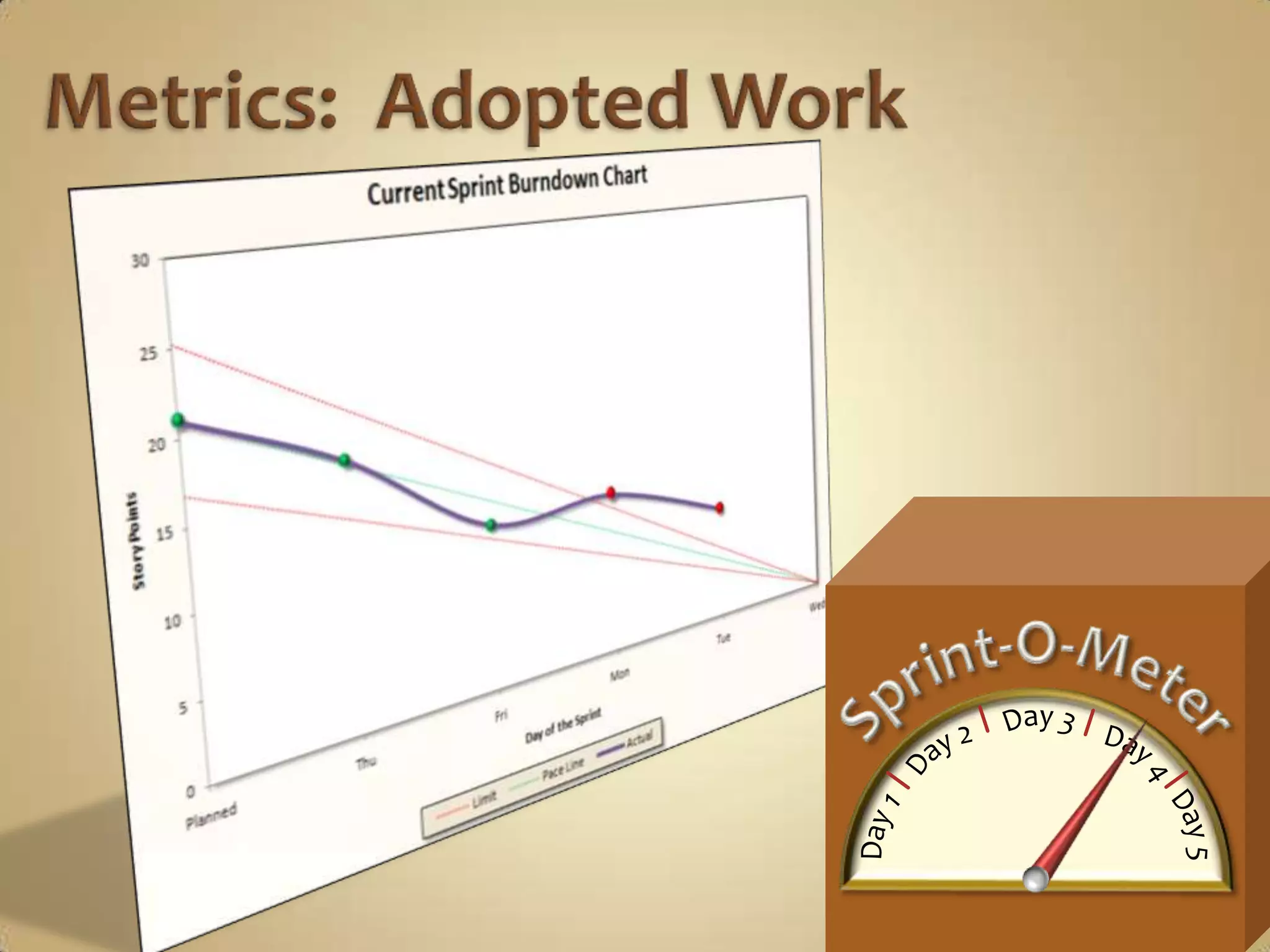

    Metrics: AdoptedWorkI, as a… a Scrum Master, who is trying to coach a team toward more accurate Commitments during each Sprint Planning Meeting,
  • 60.
    …need… a metric thatclearly shows if the Team has a tendency to under Commit and is consistently having to pull work forward from the Product Backlog before the end of the Sprint
  • 61.
    …so that… I canencourage the Team toward higher Commitments during the Sprint Planning Meetings without the risk of pushing them to failure.
  • 62.
    Formula: ∑Original Estimatesfor Work Pulled Forward Original Commitment1:1
  • 63.
    Metrics: AdoptedWorkOriginal Commitment:0349111919PBLSBLIn ProgDONEAdopted Work:000000133Total Commitment:034911193215Adopted Work = 13 ÷ 19 = 68.4%INVEST28135Sprint-O-Meter8Day 3Day 23Day 4Day 5Day 15
  • 64.
    Metrics: AdoptedWorkSprint-O-MeterDay 3Day 2Day 4Day 5Day 1
  • 65.
    Metrics: FoundWorkI, as a… a Scrum Master, who is trying to help my Team make more accurate and reliable Commitments in Sprint Planning,
  • 66.
    …need… a clear wayto measure the likelihood of unexpected work based on a Card’s Original Estimate
  • 67.
    …so that… I canoffer advice to the Team on making achievable Commitments and provide them fair warning when they start to accept a Card that will probably surprise them.
  • 68.
    Formula:∑Total Work Reportedper Card – Original Estimate Original Commitment1:1
  • 69.

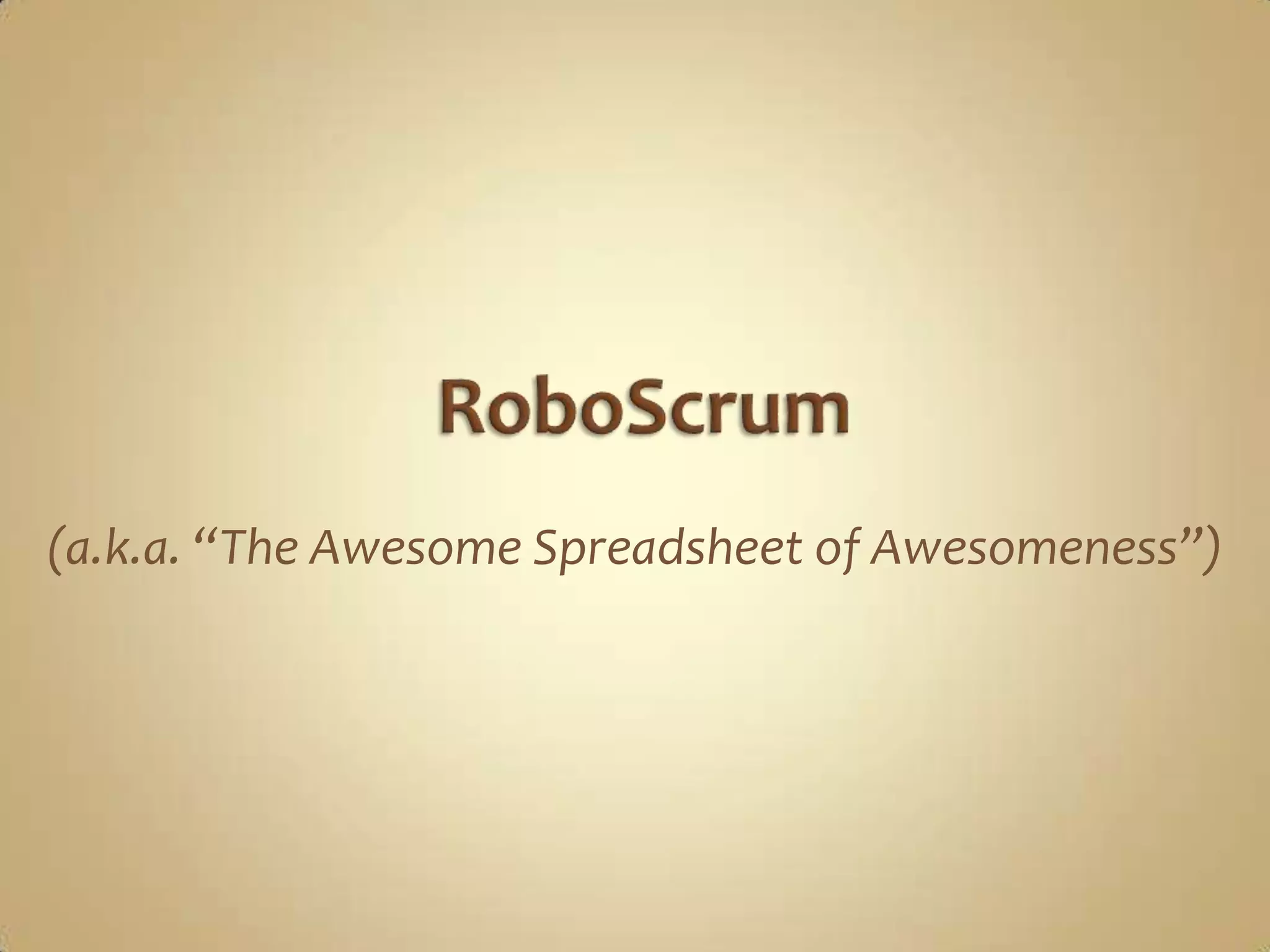

    Metrics: FoundWorkPBLSBLIn ProgDONEOriginal Commitment:193Total Commitment:Total Commitment:19221Found Work:33528135835
  • 70.
    Metrics: Found+ Adopted Work
  • 71.
    Metrics: TargetedValue IncreaseI, as a… a Scrum Product Owner who is trying to evaluate the efficacy of the product directions I have chosen
  • 72.
    …need… a reliable wayto measure the increased value contribution of the Team sprint-over-sprint
  • 73.
    …so that… I cancompare the Team’s rate of value contribution increase to the changes in revenue we are generating and adjust our direction if the value that I estimated isn’t being realized.
  • 74.
  • 75.
    Metrics: TargetedValue IncreaseSprint NumberVelocityTVI:8= 100%÷ 813= 162.5%21= 237.5%33= 412.5%42= 525%Original Velocity 2010.05.05 8Current Velocity 2010.12.05 13 2010.19.05 21 2010.26.05 37 2010.26.05 42
  • 76.
    Metrics: TargetedValue Increase
  • 77.

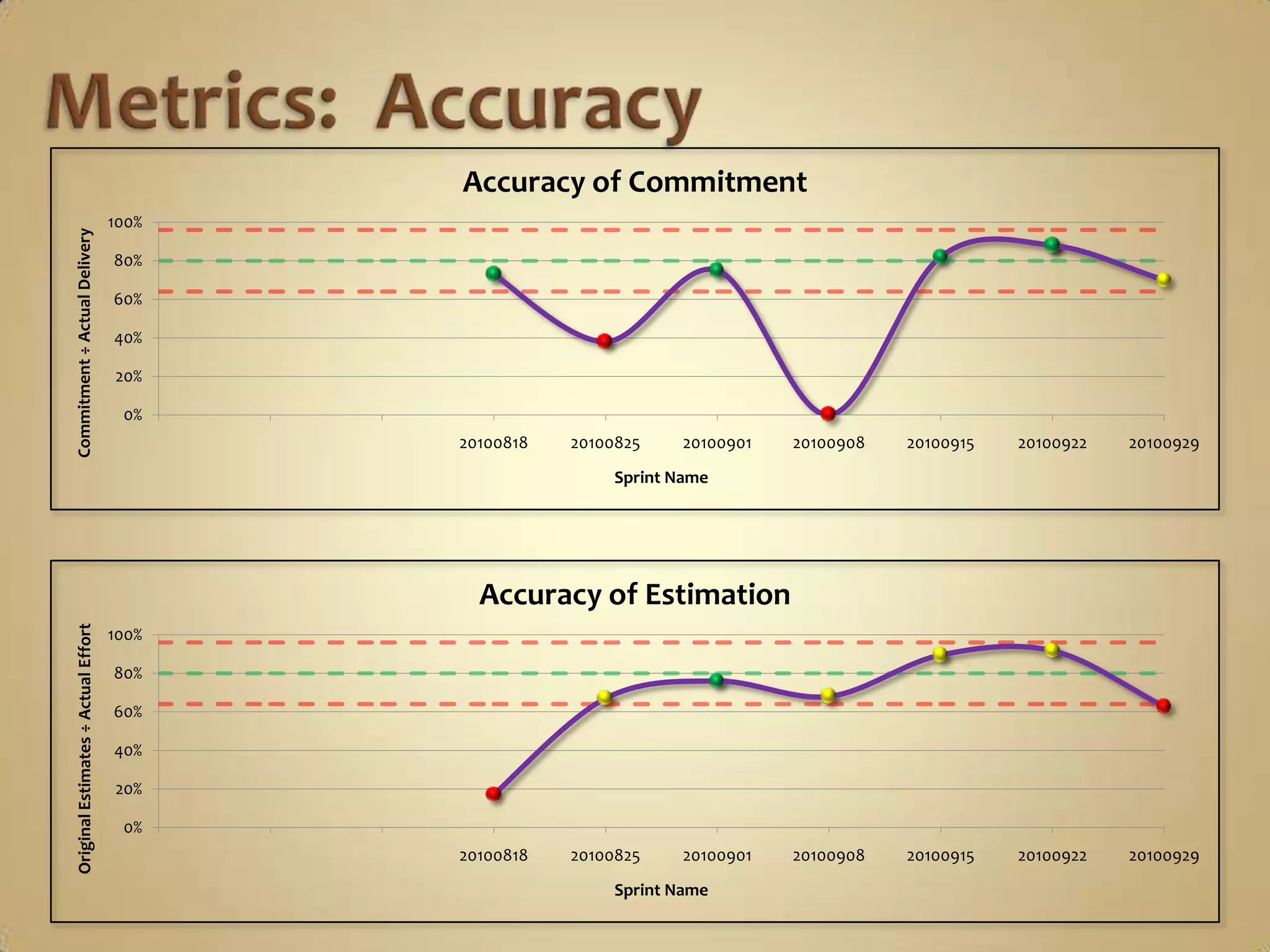

    Metrics: Accuracyof EstimationI, as a… a Scrum Product Owner who is interested in creating reliable roadmaps, including Optimistic, Likely and Pessimistic release dates for larger initiatives,
  • 78.
    …need… a metric thattracks the margin of error on the Team’s Original Estimates
  • 79.
    …so that… I canmultiply their good-faith estimates by this factor and create more realistic date projections.
  • 80.

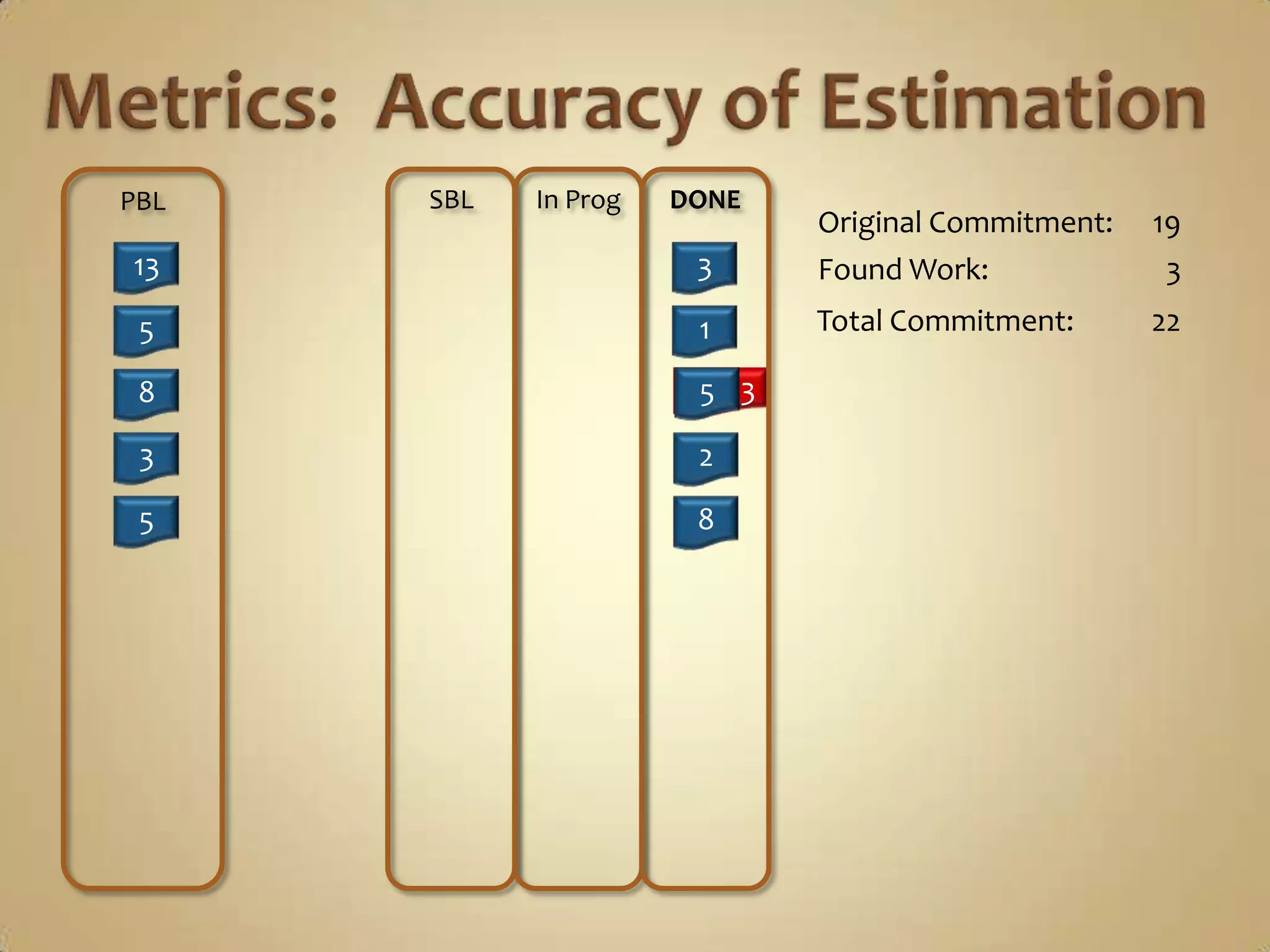

    Formula:1 – (EstimateDelta ÷ Total Commit)1:1
  • 81.
    Metrics: Accuracyof EstimationSBLIn ProgDONEPBLOriginal Commitment:19313Total Commitment:2215Found Work:35382385
  • 82.
    Metrics: Accuracyof EstimationSBLIn ProgDONEPBLOriginal Commitment:19313Total Commitment:2215Found Work:35382385
  • 83.
    Metrics: Accuracyof EstimationActualDeltaSBLIn ProgDONEOriginal Commitment:19213Total Commitment:22121Found Work:35383532Estimate Delta:9718Total Commitment:22We want about 80%!- 0.4090 =59%= 0.40900.5911W. Edwards Deming
  • 84.
    Metrics: Accuracyof EstimationDONEActualDelta2131215383532718
  • 85.
    Metrics: Accuracyof Estimation…3 5 8 13 21…11 12 13 14 15 16 17…18 19 20 21 22 23 24 25 26 2734 5 67 8 9 10…
  • 86.
    Metrics: Accuracyof CommitI, as a… a Scrum Product Owner, who is concerned about the accuracy of my Roadmaps
  • 87.
    …need… a metric thatinforms me of the margin of error when the Teamcommits to a body of work
  • 88.
    …so that… I canuse this margin of error to predict reliable dates, and know when it is safe to lobby for a higher Commitment at each Planning Meeting.
  • 89.
    Formula:(∑Original Estimates) ÷ (∑Original Estimates + ∑Adopted Work + ∑Found Work)1:1
  • 90.
  • 91.
    RoboScrum(a.k.a. “The AwesomeSpreadsheet of Awesomeness”)
  • 92.
    RoboScrum(a.k.a. “The AwesomeSpreadsheet of Awesomeness”)
  • 93.
    RoboScrumRoboScrumgives you groundsforQUESTIONSbut not forACCUSATIONS!!Not an Excel Expert (Google + F1)
  • 94.
    Offered as anExample Only
  • 95.
  • 96.
  • 97.
    Fully Acknowledge Improvementscan (and will!) be Made
  • 98.
    No Macros (forEase of Portability)
  • 99.
    Use at YourOwn Risk
  • 100.
    No Support Contractis either Expressed or Implied RoboScrumRapidScrum.comPassword: rapidscrum
