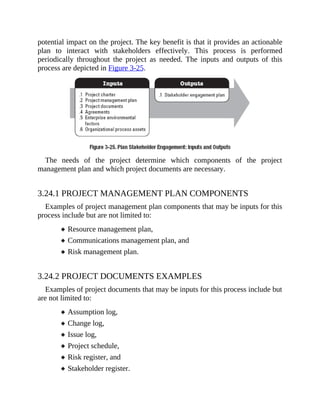

A Guide to the PROJECT
MANAGEMENT BODY OF
KNOWLEDGE
(PMBOK® GUIDE)
Sixth Edition
This book was printed utilizing a patented anti-counterfeit print technology designed to prevent
unauthorized reproductions. The paper color is gray instead of white. When the pages of the book
are copied or scanned a hidden warning message will appear in the background. This security
feature is intended to discourage anyone from attempting to illegally reproduce or counterfeit this
book.

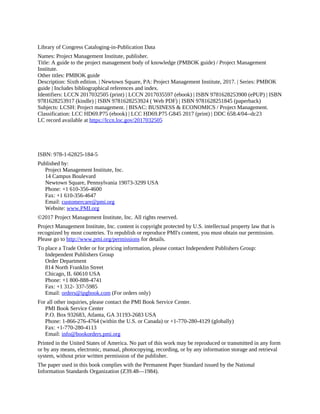

Library of Congress Cataloging-in-Publication Data
Names: Project Management Institute, publisher.
Title: A guide to the project management body of knowledge (PMBOK guide) / Project Management
Institute.
Other titles: PMBOK guide
Description: Sixth edition. | Newtown Square, PA: Project Management Institute, 2017. | Series: PMBOK
guide | Includes bibliographical references and index.
Identifiers: LCCN 2017032505 (print) | LCCN 2017035597 (ebook) | ISBN 9781628253900 (ePUP) | ISBN
9781628253917 (kindle) | ISBN 9781628253924 ( Web PDF) | ISBN 9781628251845 (paperback)
Subjects: LCSH: Project management. | BISAC: BUSINESS & ECONOMICS / Project Management.
Classification: LCC HD69.P75 (ebook) | LCC HD69.P75 G845 2017 (print) | DDC 658.4/04--dc23
LC record available at https://lccn.loc.gov/2017032505
ISBN: 978-1-62825-184-5
Published by:
Project Management Institute, Inc.
14 Campus Boulevard
Newtown Square, Pennsylvania 19073-3299 USA
Phone: +1 610-356-4600
Fax: +1 610-356-4647
Email: customercare@pmi.org
Website: www.PMI.org
©2017 Project Management Institute, Inc. All rights reserved.
Project Management Institute, Inc. content is copyright protected by U.S. intellectual property law that is
recognized by most countries. To republish or reproduce PMI's content, you must obtain our permission.
Please go to http://www.pmi.org/permissions for details.
To place a Trade Order or for pricing information, please contact Independent Publishers Group:
Independent Publishers Group
Order Department
814 North Franklin Street
Chicago, IL 60610 USA
Phone: +1 800-888-4741
Fax: +1 312- 337-5985
Email: orders@ipgbook.com (For orders only)
For all other inquiries, please contact the PMI Book Service Center.
PMI Book Service Center
P.O. Box 932683, Atlanta, GA 31193-2683 USA
Phone: 1-866-276-4764 (within the U.S. or Canada) or +1-770-280-4129 (globally)
Fax: +1-770-280-4113
Email: info@bookorders.pmi.org
Printed in the United States of America. No part of this work may be reproduced or transmitted in any form
or by any means, electronic, manual, photocopying, recording, or by any information storage and retrieval
system, without prior written permission of the publisher.
The paper used in this book complies with the Permanent Paper Standard issued by the National
Information Standards Organization (Z39.48—1984).
PMI, the PMI logo, PMBOK, OPM3, PMP, CAPM, PgMP, PfMP, PMI-RMP, PMI-SP, PMI-ACP, PMI-
PBA, PROJECT MANAGEMENT JOURNAL, PM NETWORK, PMI TODAY, PULSE OF THE
PROFESSION and the slogan MAKING PROJECT MANAGEMENT INDISPENSABLE FOR
BUSINESS RESULTS. are all marks of Project Management Institute, Inc. For a comprehensive list of
PMI trademarks, contact the PMI Legal Department. All other trademarks, service marks, trade names,
trade dress, product names and logos appearing herein are the property of their respective owners. Any
rights not expressly granted herein are reserved.
10 9 8 7 6 5 4 3 2 1

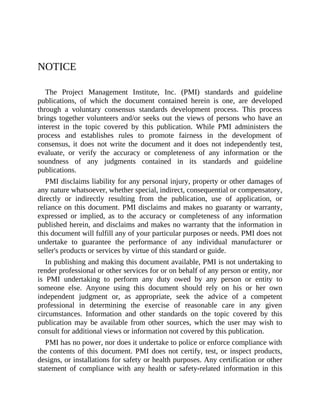

NOTICE
The Project Management Institute, Inc. (PMI) standards and guideline
publications, of which the document contained herein is one, are developed
through a voluntary consensus standards development process. This process
brings together volunteers and/or seeks out the views of persons who have an
interest in the topic covered by this publication. While PMI administers the
process and establishes rules to promote fairness in the development of
consensus, it does not write the document and it does not independently test,
evaluate, or verify the accuracy or completeness of any information or the
soundness of any judgments contained in its standards and guideline
publications.
PMI disclaims liability for any personal injury, property or other damages of
any nature whatsoever, whether special, indirect, consequential or compensatory,
directly or indirectly resulting from the publication, use of application, or
reliance on this document. PMI disclaims and makes no guaranty or warranty,
expressed or implied, as to the accuracy or completeness of any information
published herein, and disclaims and makes no warranty that the information in
this document will fulfill any of your particular purposes or needs. PMI does not
undertake to guarantee the performance of any individual manufacturer or
seller's products or services by virtue of this standard or guide.
In publishing and making this document available, PMI is not undertaking to
render professional or other services for or on behalf of any person or entity, nor
is PMI undertaking to perform any duty owed by any person or entity to
someone else. Anyone using this document should rely on his or her own
independent judgment or, as appropriate, seek the advice of a competent
professional in determining the exercise of reasonable care in any given
circumstances. Information and other standards on the topic covered by this
publication may be available from other sources, which the user may wish to
consult for additional views or information not covered by this publication.
PMI has no power, nor does it undertake to police or enforce compliance with
the contents of this document. PMI does not certify, test, or inspect products,
designs, or installations for safety or health purposes. Any certification or other
statement of compliance with any health or safety-related information in this
document shall not be attributable to PMI and is solely the responsibility of the
certifier or maker of the statement.

TABLE OF CONTENTS
PART 1.
A GUIDE TO THE PROJECT MANAGEMENT BODY OF
KNOWLEDGE (PMBOK® Guide)

1. INTRODUCTION

1.1 Overview and Purpose of this Guide
1.1.1 The Standard for Project Management
1.1.2 Common Vocabulary

1.1.3 Code of Ethics and Professional Conduct
1.2 Foundational Elements

1.2.1 Projects
1.2.2 The Importance of Project Management

1.2.3 Relationship of Project, Program, Portfolio, and
Operations Management

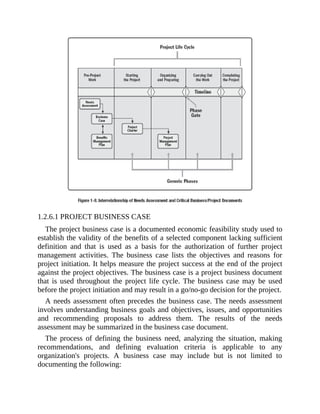

1.2.4 Components of the Guide

1.2.5 Tailoring
1.2.6 Project Management Business Documents
2. THE ENVIRONMENT IN WHICH PROJECTS OPERATE
2.1 Overview

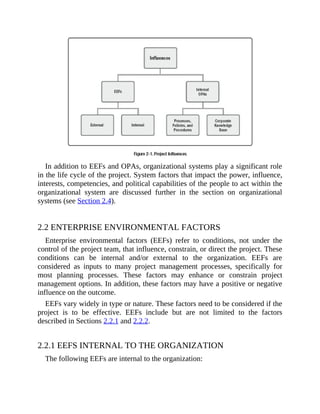

2.2 Enterprise Environmental Factors
2.2.1 EEFs Internal to the Organization
2.2.2 EEFs External to the Organization

2.3 Organizational Process Assets
2.3.1 Processes, Policies, and Procedures
2.3.2 Organizational Knowledge Repositories

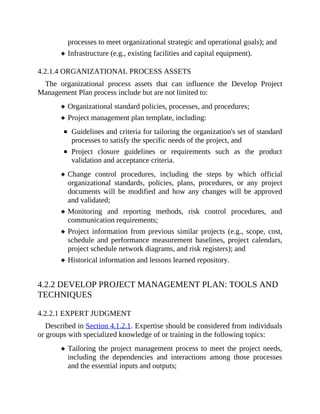

2.4 Organizational Systems

2.4.1 Overview
2.4.2 Organizational Governance Frameworks
2.4.3 Management Elements
2.4.4 Organizational Structure Types
3. THE ROLE OF THE PROJECT MANAGER
3.1 Overview
3.2 Definition of a Project Manager
3.3 The Project Manager's Sphere of Influence
3.3.1 Overview
3.3.2 The Project
3.3.3 The Organization
3.3.4 The Industry
3.3.5 Professional Discipline
3.3.6 Across Disciplines

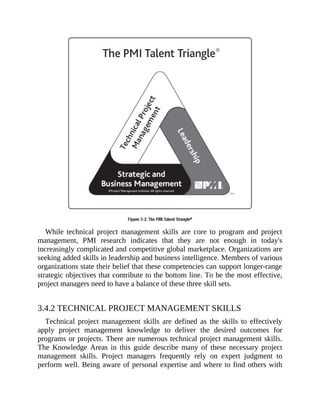

3.4 Project Manager Competences
3.4.1 Overview
3.4.2 Technical Project Management Skills
3.4.3 Strategic and Business Management Skills

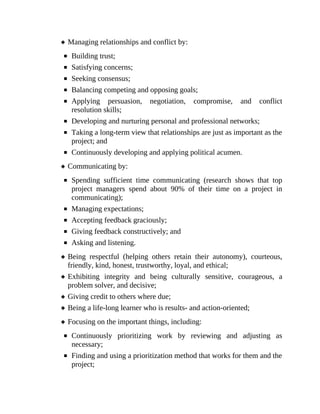

3.4.4 Leadership Skills
3.4.5 Comparison of Leadership and Management
3.5 Performing Integration
3.5.1 Performing Integration at the Process Level
3.5.2 Integration at the Cognitive Level

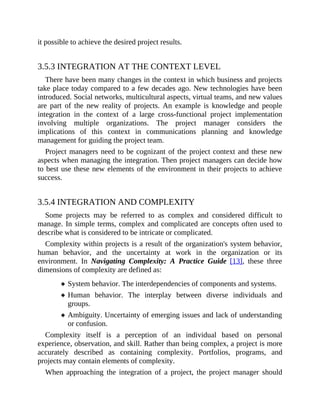

3.5.3 Integration at the Context Level
3.5.4 Integration and Complexity

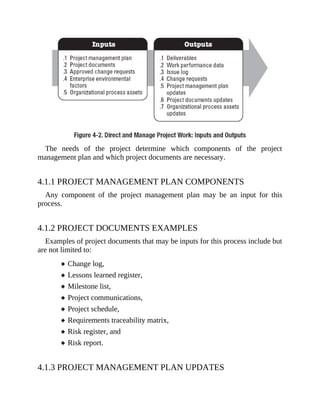

4. PROJECT INTEGRATION MANAGEMENT

4.1 Develop Project Charter
4.1.1 Develop Project Charter: Inputs
4.1.2 Develop Project Charter: Tools and Techniques
4.1.3 Develop Project Charter: Outputs
4.2 Develop Project Management Plan
4.2.1 Develop Project Management Plan: Inputs
4.2.2 Develop Project Management Plan: Tools and
Techniques
4.2.3 Develop Project Management Plan: Outputs

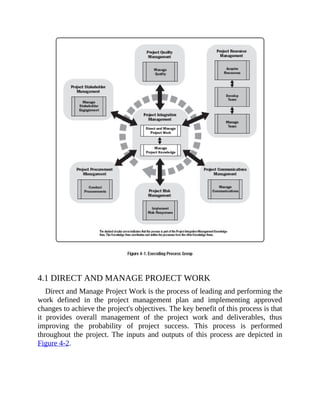

4.3 Direct and Manage Project Work
4.3.1 Direct and Manage Project Work: Inputs
4.3.2 Direct and Manage Project Work: Tools and Techniques
4.3.3 Direct and Manage Project Work: Outputs

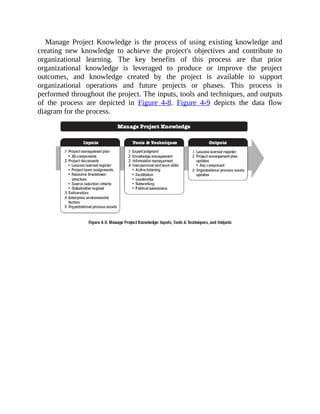

4.4 Manage Project Knowledge
4.4.1 Manage Project Knowledge: Inputs
4.4.2 Manage Project Knowledge: Tools and Techniques
4.4.3 Manage Project Knowledge: Outputs
4.5 Monitor and Control Project Work
4.5.1 Monitor and Control Project Work: Inputs
4.5.2 Monitor and Control Project Work: Tools and
Techniques
4.5.3 Monitor and Control Project Work: Outputs

4.6 Perform Integrated Change Control
4.6.1 Perform Integrated Change Control: Inputs
4.6.2 Perform Integrated Change Control: Tools and
Techniques
4.6.3 Perform Integrated Change Control: Outputs

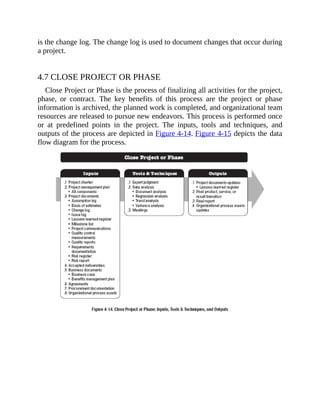

4.7 Close Project or Phase
4.7.1 Close Project or Phase: Inputs
4.7.2 Close Project or Phase: Tools and Techniques
4.7.3 Close Project or Phase: Outputs
5. PROJECT SCOPE MANAGEMENT
5.1 Plan Scope Management
5.1.1 Plan Scope Management: Inputs
5.1.2 Plan Scope Management: Tools and Techniques
5.1.3 Plan Scope Management: Outputs
5.2 Collect Requirements
5.2.1 Collect Requirements: Inputs
5.2.2 Collect Requirements: Tools and Techniques
5.2.3 Collect Requirements: Outputs
5.3 Define Scope
5.3.1 Define Scope: Inputs
5.3.2 Define Scope: Tools and Techniques
5.3.3 Define Scope: Outputs

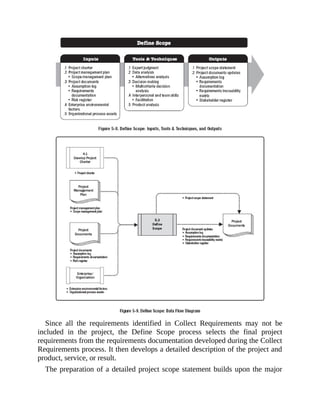

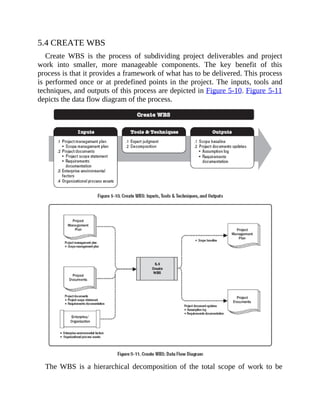

5.4 Create WBS
5.4.1 Create WBS: Inputs
5.4.2 Create WBS: Tools and Techniques
5.4.3 Create WBS: Outputs
5.5 Validate Scope
5.5.1 Validate Scope: Inputs
5.5.2 Validate Scope: Tools and Techniques
5.5.3 Validate Scope: Outputs
5.6 Control Scope
5.6.1 Control Scope: Inputs
5.6.2 Control Scope: Tools and Techniques
5.6.3 Control Scope: Outputs

6. PROJECT SCHEDULE MANAGEMENT

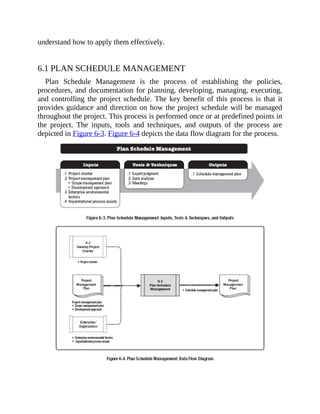

6.1 Plan Schedule Management
6.1.1 Plan Schedule Management: Inputs
6.1.2 Plan Schedule Management: Tools and Techniques
6.1.3 Plan Schedule Management: Outputs

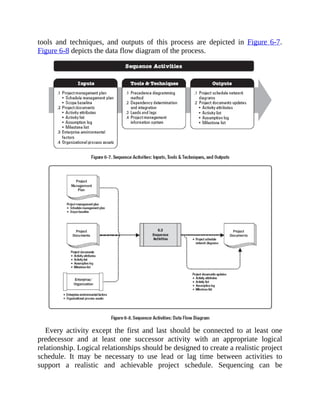

6.2 Define Activities
6.2.1 Define Activities: Inputs
6.2.2 Define Activities: Tools and Techniques
6.2.3 Define Activities: Outputs
6.3 Sequence Activities
6.3.1 Sequence Activities: Inputs
6.3.2 Sequence Activities: Tools and Techniques
6.3.3 Sequence Activities: Outputs

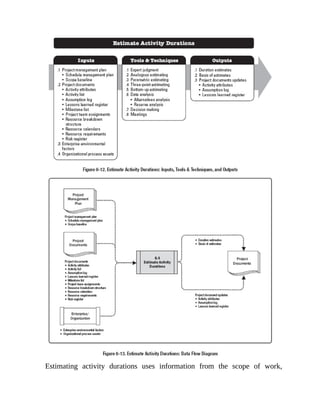

6.4 Estimate Activity Durations

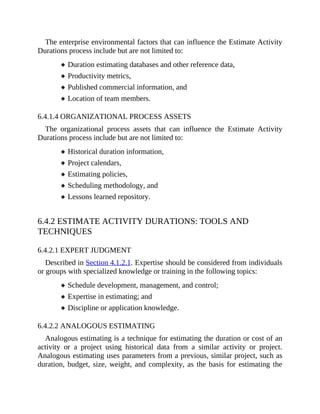

6.4.1 Estimate Activity Durations: Inputs
6.4.2 Estimate Activity Durations: Tools and Techniques
6.4.3 Estimate Activity Durations: Outputs

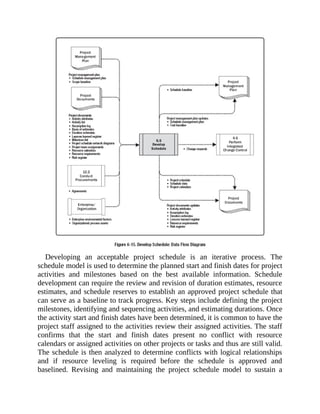

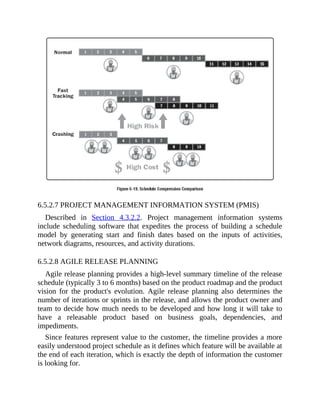

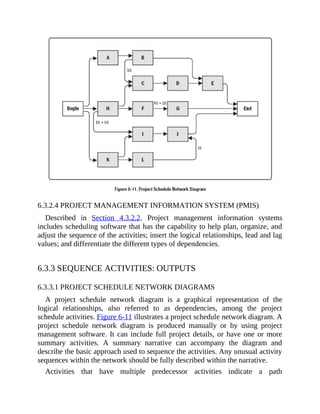

6.5 Develop Schedule
6.5.1 Develop Schedule: Inputs
6.5.2 Develop Schedule: Tools and Techniques

6.5.3 Develop Schedule: Outputs

6.6 Control Schedule
6.6.1 Control Schedule: Inputs
6.6.2 Control Schedule: Tools and Techniques
6.6.3 Control Schedule: Outputs

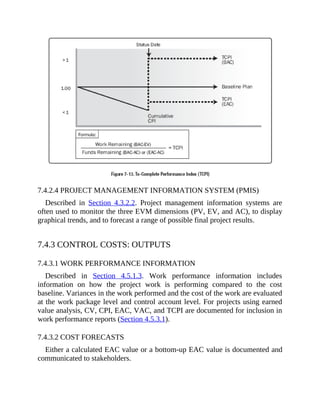

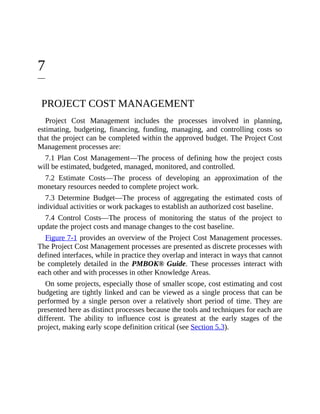

7. PROJECT COST MANAGEMENT
7.1 Plan Cost Management
7.1.1 Plan Cost Management: Inputs
7.1.2 Plan Cost Management: Tools and Techniques
7.1.3 Plan Cost Management: Outputs
7.2 Estimate Costs
7.2.1 Estimate Costs: Inputs
7.2.2 Estimate Costs: Tools and Techniques
7.2.3 Estimate Costs: Outputs

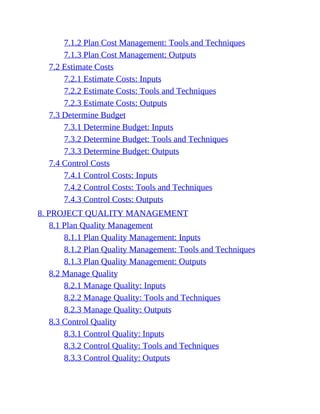

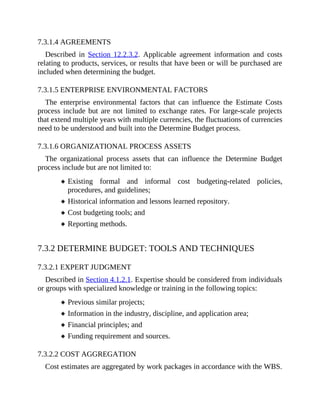

7.3 Determine Budget
7.3.1 Determine Budget: Inputs
7.3.2 Determine Budget: Tools and Techniques
7.3.3 Determine Budget: Outputs
7.4 Control Costs
7.4.1 Control Costs: Inputs
7.4.2 Control Costs: Tools and Techniques
7.4.3 Control Costs: Outputs

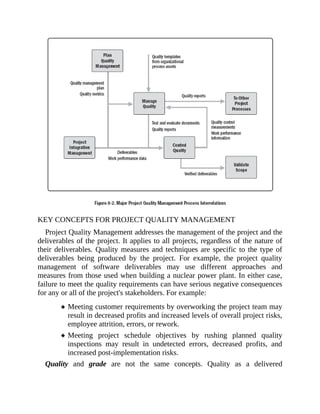

8. PROJECT QUALITY MANAGEMENT
8.1 Plan Quality Management
8.1.1 Plan Quality Management: Inputs
8.1.2 Plan Quality Management: Tools and Techniques
8.1.3 Plan Quality Management: Outputs
8.2 Manage Quality
8.2.1 Manage Quality: Inputs
8.2.2 Manage Quality: Tools and Techniques
8.2.3 Manage Quality: Outputs
8.3 Control Quality
8.3.1 Control Quality: Inputs
8.3.2 Control Quality: Tools and Techniques
8.3.3 Control Quality: Outputs

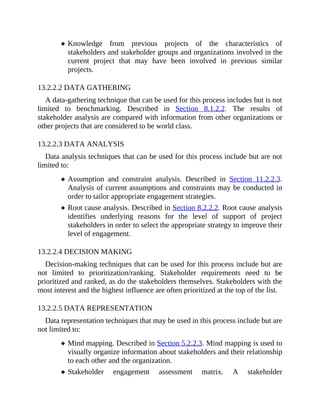

9. PROJECT RESOURCE MANAGEMENT
9.1 Plan Resource Management
9.1.1 Plan Resource Management: Inputs
9.1.2 Plan Resource Management: Tools and Techniques
9.1.3 Plan Resource Management: Outputs
9.2 Estimate Activity Resources
9.2.1 Estimate Activity Resources: Inputs
9.2.2 Estimate Activity Resources: Tools and Techniques
9.2.3 Estimate Activity Resources: Outputs

9.3 Acquire Resources

9.3.1 Acquire Resources: Inputs

9.3.2 Acquire Resources: Tools and Techniques
9.3.3 Acquire Resources: Outputs
9.4 Develop Team
9.4.1 Develop Team: Inputs

9.4.2 Develop Team: Tools and Techniques
9.4.3 Develop Team: Outputs

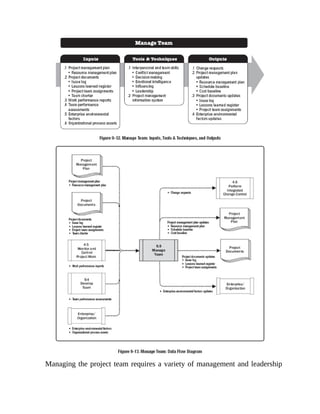

9.5 Manage Team
9.5.1 Manage Team: Inputs

9.5.2 Manage Team: Tools and Techniques
9.5.3 Manage Team: Outputs

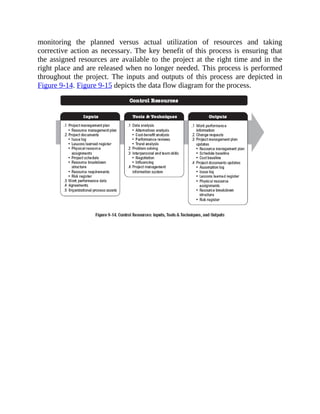

9.6 Control Resources
9.6.1 Control Resources: Inputs
9.6.2 Control Resources: Tools and Techniques
9.6.3 Control Resources: Outputs

10. PROJECT COMMUNICATIONS MANAGEMENT
10.1 Plan Communications Management
10.1.1 Plan Communications Management: Inputs
10.1.2 Plan Communications Management: Tools and
Techniques

10.1.3 Plan Communications Management: Outputs

10.2 Manage Communications
10.2.1 Manage Communications: Inputs
10.2.2 Manage Communications: Tools and Techniques
10.2.3 Manage Communications: Outputs
10.3 Monitor Communications
10.3.1 Monitor Communications: Inputs
10.3.2 Monitor Communications: Tools and Techniques
10.3.3 Monitor Communications: Outputs
11. PROJECT RISK MANAGEMENT

11.1 Plan Risk Management
11.1.1 Plan Risk Management: Inputs
11.1.2 Plan Risk Management: Tools and Techniques
11.1.3 Plan Risk Management: Outputs

11.2 Identify Risks
11.2.1 Identify Risks: Inputs
11.2.2 Identify Risks: Tools and Techniques
11.2.3 Identify Risks: Outputs
11.3 Perform Qualitative Risk Analysis
11.3.1 Perform Qualitative Risk Analysis: Inputs
11.3.2 Perform Qualitative Risk Analysis: Tools and
Techniques
11.3.3 Perform Qualitative Risk Analysis: Outputs
11.4 Perform Quantitative Risk Analysis
11.4.1 Perform Quantitative Risk Analysis: Inputs
11.4.2 Perform Quantitative Risk Analysis: Tools and
Techniques
11.4.3 Perform Quantitative Risk Analysis: Outputs
11.5 Plan Risk Responses
11.5.1 Plan Risk Responses: Inputs
11.5.2 Plan Risk Responses: Tools and Techniques
11.5.3 Plan Risk Responses: Outputs
11.6 Implement Risk Responses
11.6.1 Implement Risk Responses: Inputs
11.6.2 Implement Risk Responses: Tools and Techniques
11.6.3 Implement Risk Responses: Outputs

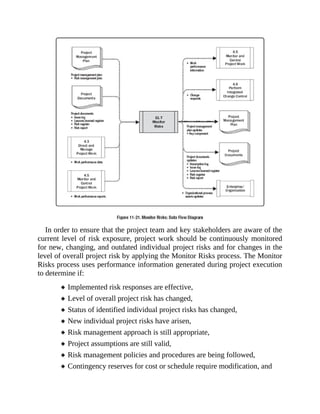

11.7 Monitor Risks
11.7.1 Monitor Risks: Inputs
11.7.2 Monitor Risks: Tools and Techniques
11.7.3 Monitor Risks: Outputs
12. PROJECT PROCUREMENT MANAGEMENT
12.1 Plan Procurement Management
12.1.1 Plan Procurement Management: Inputs
12.1.2 Plan Procurement Management: Tools and Techniques
12.1.3 Plan Procurement Management: Outputs
12.2 Conduct Procurements
12.2.1 Conduct Procurements: Inputs
12.2.2 Conduct Procurements: Tools and Techniques
12.2.3 Conduct Procurements: Outputs

12.3 Control Procurements
12.3.1 Control Procurements: Inputs
12.3.2 Control Procurements: Tools and Techniques
12.3.3 Control Procurements: Outputs

13. PROJECT STAKEHOLDER MANAGEMENT
13.1 Identify Stakeholders
13.1.1 Identify Stakeholders: Inputs
13.1.2 Identify Stakeholders: Tools and Techniques
13.1.3 Identify Stakeholders: Outputs

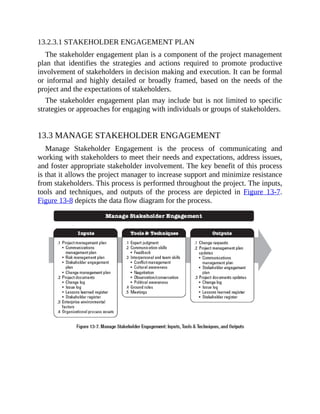

13.2 Plan Stakeholder Engagement
13.2.1 Plan Stakeholder Engagement: Inputs
13.2.2 Plan Stakeholder Engagement: Tools and Techniques
13.2.3 Plan Stakeholder Engagement: Outputs
13.3 Manage Stakeholder Engagement
13.3.1 Manage Stakeholder Engagement: Inputs
13.3.2 Manage Stakeholder Engagement: Tools and
Techniques
13.3.3 Manage Stakeholder Engagement: Outputs
13.4 Monitor Stakeholder Engagement
13.4.1 Monitor Stakeholder Engagement: Inputs
13.4.2 Monitor Stakeholder Engagement: Tools and
Techniques
13.4.3 Monitor Stakeholder Engagement: Outputs
REFERENCES
PART 2.
THE STANDARD FOR PROJECT MANAGEMENT
1. INTRODUCTION
1.1 Projects and Project Management
1.2 Relationships Among Portfolios, Programs, and Projects
1.3 Linking Organizational Governance and Project Governance

1.4 Project Success and Benefits Management
1.5 The Project Life Cycle
1.6 Project Stakeholders
1.7 Role of the Project Manager
1.8 Project Management Knowledge Areas
1.9 Project Management Process Groups
1.10 Enterprise Environmental Factors and Organizational Process
Assets
1.11 Tailoring the Project Artifacts
2. INITIATING PROCESS GROUP
2.1 Develop Project Charter
2.2 Identify Stakeholders
2.2.1 Project Management Plan Components
2.2.2 Project Documents Examples
2.2.3 Project Management Plan Updates
2.2.4 Project Documents Updates

3. PLANNING PROCESS GROUP
3.1 Develop Project Management Plan
3.2 Plan Scope Management
3.2.1 Project Management Plan Components

3.3 Collect Requirements
3.3.1 Project Management Plan Components
3.3.2 Project Documents Examples
3.4 Define Scope
3.4.1 Project Management Plan Components
3.4.2 Project Documents Examples
3.4.3 Project Documents Updates

3.5 Create WBS

3.5.1 Project Management Plan Components
3.5.2 Project Documents Examples
3.5.3 Project Documents Updates

3.6 Plan Schedule Management
3.6.1 Project Management Plan Components
3.7 Define Activities
3.7.1 Project Management Plan Components
3.7.2 Project Management Plan Updates
3.8 Sequence Activities
3.8.1 Project Management Plan Components
3.8.2 Project Documents Examples
3.8.3 Project Documents Updates
3.9 Estimate Activity Durations
3.9.1 Project Management Plan Components
3.9.2 Project Documents Examples
3.9.3 Project Documents Updates

3.10 Develop Schedule
3.10.1 Project Management Plan Components
3.10.2 Project Documents Examples
3.10.3 Project Management Plan Updates
3.10.4 Project Documents Updates
3.11 Plan Cost Management
3.11.1 Project Management Plan Components

3.12 Estimate Costs
3.12.1 Project Management Plan Components
3.12.2 Project Documents Examples
3.12.3 Project Documents Updates
3.13 Determine Budget
3.13.1 Project Management Plan Components
3.13.2 Project Documents Examples
3.13.3 Project Documents Updates
3.14 Plan Quality Management
3.14.1 Project Management Plan Components
3.14.2 Project Documents Examples
3.14.3 Project Management Plan Updates
3.14.4 Project Documents Updates

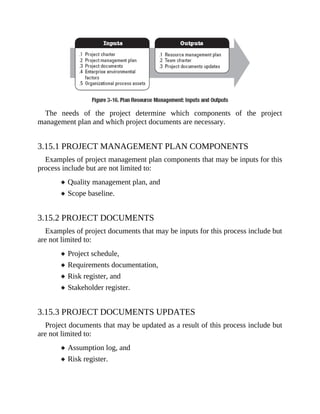

3.15 Plan Resource Management
3.15.1 Project Management Plan Components
3.15.2 Project Documents
3.15.3 Project Documents Updates
3.16 Estimate Activity Resources
3.16.1 Project Management Plan Components

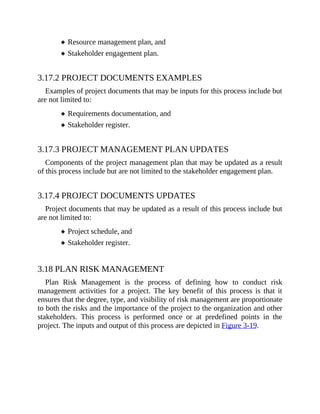

3.16.2 Project Documents Examples
3.16.3 Project Documents Updates
3.17 Plan Communications Management
3.17.1 Project Management Plan Components
3.17.2 Project Documents Examples
3.17.3 Project Management Plan Updates
3.17.4 Project Documents Updates

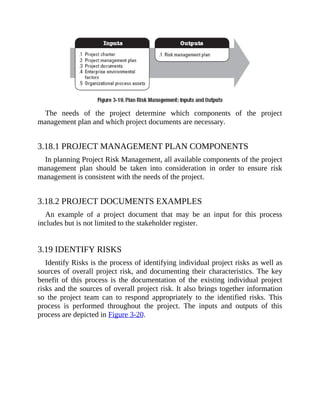

3.18 Plan Risk Management
3.18.1 Project Management Plan Components
3.18.2 Project Documents Examples
3.19 Identify Risks
3.19.1 Project Management Plan Components
3.19.2 Project Documents Examples
3.19.3 Project Documents Updates
3.20 Perform Qualitative Risk Analysis
3.20.1 Project Management Plan Components
3.20.2 Project Documents Examples
3.20.3 Project Documents Updates
3.21 Perform Quantitative Risk Analysis
3.21.1 Project Management Plan Components
3.21.2 Project Documents Examples
3.21.3 Project Documents Updates
3.22 Plan Risk Responses
3.22.1 Project Management Plan Components
3.22.2 Project Documents Examples
3.22.3 Project Management Plan Updates
3.22.4 Project Documents Updates
3.23 Plan Procurement Management
3.23.1 Project Management Plan Components
3.23.2 Project Documents Examples
3.23.3 Project Documents Updates
3.24 Plan Stakeholder Engagement
3.24.1 Project Management Plan Components
3.24.2 Project Documents Examples

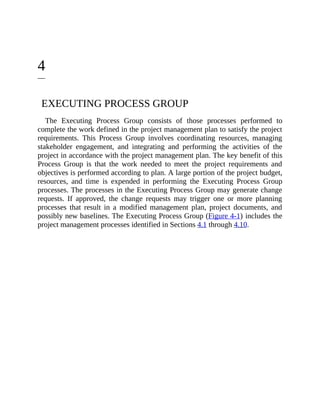

4. EXECUTING PROCESS GROUP
4.1 Direct and Manage Project Work
4.1.1 Project Management Plan Components
4.1.2 Project Documents Examples
4.1.3 Project Management Plan Updates
4.1.4 Project Documents Updates
4.2 Manage Project Knowledge
4.2.1 Project Management Plan Components
4.2.2 Project Documents
4.2.3 Project Management Plan Updates

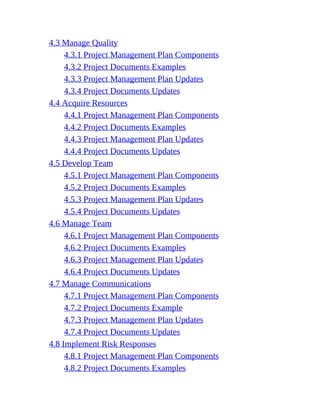

4.3 Manage Quality
4.3.1 Project Management Plan Components
4.3.2 Project Documents Examples
4.3.3 Project Management Plan Updates
4.3.4 Project Documents Updates

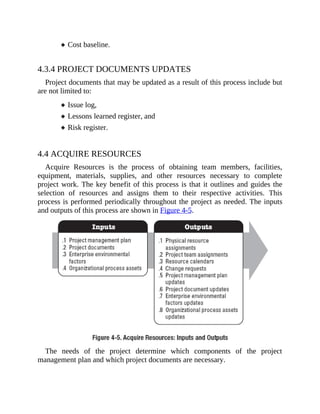

4.4 Acquire Resources
4.4.1 Project Management Plan Components
4.4.2 Project Documents Examples
4.4.3 Project Management Plan Updates
4.4.4 Project Documents Updates
4.5 Develop Team
4.5.1 Project Management Plan Components
4.5.2 Project Documents Examples
4.5.3 Project Management Plan Updates
4.5.4 Project Documents Updates
4.6 Manage Team
4.6.1 Project Management Plan Components
4.6.2 Project Documents Examples
4.6.3 Project Management Plan Updates
4.6.4 Project Documents Updates
4.7 Manage Communications
4.7.1 Project Management Plan Components
4.7.2 Project Documents Example
4.7.3 Project Management Plan Updates
4.7.4 Project Documents Updates
4.8 Implement Risk Responses
4.8.1 Project Management Plan Components
4.8.2 Project Documents Examples
4.8.3 Project Documents Updates

4.9 Conduct Procurements
4.9.1 Project Management Plan Components
4.9.2 Project Documents Examples
4.9.3 Project Management Plan Updates
4.9.4 Project Documents Updates
4.10 Manage Stakeholder Engagement
4.10.1 Project Management Plan Components
4.10.2 Project Documents Examples
4.10.3 Project Management Plan Updates
4.10.4 Project Documents Updates
5. MONITORING AND CONTROLLING PROCESS GROUP

5.1 Monitor and Control Project Work
5.1.1 Project Management Plan Components
5.1.2 Project Documents Examples
5.1.3 Project Management Plan Updates
5.1.4 Project Documents Updates

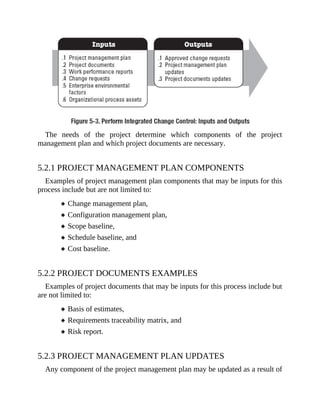

5.2 Perform Integrated Change Control
5.2.1 Project Management Plan Components
5.2.2 Project Documents Examples
5.2.3 Project Management Plan Updates
5.2.4 Project Documents Updates
5.3 Validate Scope
5.3.1 Project Management Plan Components
5.3.2 Project Documents Examples
5.3.3 Project Documents Updates
5.4 Control Scope
5.4.1 Project Management Plan Components
5.4.2 Project Documents Examples
5.4.3 Project Management Plan Updates
5.4.4 Project Documents Updates

5.5 Control Schedule
5.5.1 Project Management Plan Components
5.5.2 Project Documents Examples
5.5.3 Project Management Plan Updates
5.5.4 Project Documents Updates
5.6 Control Costs
5.6.1 Project Management Plan Components
5.6.2 Project Documents Examples
5.6.3 Project Management Plan Updates
5.6.4 Project Documents Updates
5.7 Control Quality
5.7.1 Project Management Plan Components
5.7.2 Project Documents Examples
5.7.3 Project Management Plan Updates
5.7.4 Project Documents Updates
5.8 Control Resources

5.8.1 Project Management Plan Components
5.8.2 Project Documents Examples
5.8.3 Project Management Plan Updates
5.8.4 Project Documents Updates
5.9 Monitor Communications
5.9.1 Project Management Plan Components
5.9.2 Project Documents Examples
5.9.3 Project Management Plan Updates
5.9.4 Project Documents Updates
5.10 Monitor Risks
5.10.1 Project Management Plan Components

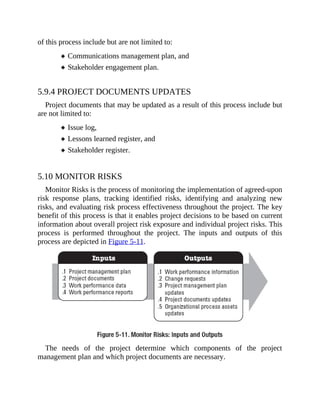

5.10.2 Project Documents Examples
5.10.3 Project Management Plan Updates
5.10.4 Project Documents Updates
5.11 Control Procurements
5.11.1 Project Management Plan Components
5.11.2 Project Documents Examples
5.11.3 Project Management Plan Updates
5.11.4 Project Documents Updates
5.12 Monitor Stakeholder Engagement
5.12.1 Project Management Plan Components
5.12.2 Project Documents Examples

5.12.3 Project Management Plan Updates
5.12.4 Project Documents Updates

6. CLOSING PROCESS GROUP
6.1 Close Project or Phase
6.1.1 Project Management Plan Components
6.1.2 Project Documents Examples
6.1.3 Project Documents Updates
PART 3.

APPENDICES, GLOSSARY, AND INDEX
APPENDIX X1

SIXTH EDITION CHANGES
APPENDIX X2
CONTRIBUTORS AND REVIEWERS OF THE PMBOK® GUIDE
—SIXTH EDITION
APPENDIX X3
AGILE, ITERATIVE, ADAPTIVE, AND HYBRID PROJECT
ENVIRONMENTS
APPENDIX X4
SUMMARY OF KEY CONCEPTS FOR KNOWLEDGE AREAS
APPENDIX X5
SUMMARY OF TAILORING CONSIDERATIONS FOR
KNOWLEDGE AREAS
APPENDIX X6
TOOLS AND TECHNIQUES

GLOSSARY

LIST OF TABLES AND FIGURES
PART 1.
A GUIDE TO THE PROJECT MANAGEMENT BODY OF
KNOWLEDGE (PMBOK® Guide)

Figure 1-1. Organizational State Transition via a Project
Figure 1-2. Project Initiation Context
Figure 1-3. Portfolio, Programs, Projects, and Operations
Figure 1-4. Organizational Project Management
Figure 1-5. Interrelationship of PMBOK® Guide Key Components
in Projects
Figure 1-6. Example Process: Inputs, Tools & Techniques, and
Outputs
Figure 1-7. Project Data, Information, and Report Flow
Figure 1-8. Interrelationship of Needs Assessment and Critical
Business/Project Documents
Figure 2-1. Project Influences
Figure 3-1. Example of Project Manager's Sphere of Influence
Figure 3-2. The PMI Talent Triangle®

Figure 4-1. Project Integration Management Overview
Figure 4-2. Develop Project Charter: Inputs, Tools & Techniques,
and Outputs
Figure 4-3. Develop Project Charter: Data Flow Diagram
Figure 4-4. Develop Project Management Plan: Inputs, Tools &
Techniques, and Outputs
Figure 4-5. Develop Project Management Plan: Data Flow
Diagram
Figure 4-6. Direct and Manage Project Work: Inputs, Tools &
Techniques, and Outputs
Figure 4-7. Direct and Manage Project Work: Data Flow Diagram
Figure 4-8. Manage Project Knowledge: Inputs, Tools &
Techniques, and Outputs
Figure 4-9. Manage Project Knowledge: Data Flow Diagram
Figure 4-10. Monitor and Control Project Work: Inputs, Tools &
Techniques, and Outputs
Figure 4-11. Monitor and Control Project Work: Data Flow
Diagram
Figure 4-12. Perform Integrated Change Control: Inputs, Tools &
Techniques, and Outputs
Figure 4-13. Perform Integrated Change Control: Data Flow
Diagram
Figure 4-14. Close Project or Phase: Inputs, Tools & Techniques,
and Outputs
Figure 4-15. Close Project or Phase: Data Flow Diagram
Figure 5-1. Project Scope Management Overview
Figure 5-2. Plan Scope Management: Inputs, Tools & Techniques,
and Outputs
Figure 5-3. Plan Scope Management: Data Flow Diagram
Figure 5-4. Collect Requirements: Inputs, Tools & Techniques,
and Outputs
Figure 5-5. Collect Requirements: Data Flow Diagram
Figure 5-6. Context Diagram
Figure 5-7. Example of a Requirements Traceability Matrix
Figure 5-8. Define Scope: Inputs, Tools & Techniques, and
Outputs
Figure 5-9. Define Scope: Data Flow Diagram
Figure 5-10. Create WBS: Inputs, Tools & Techniques, and Outputs
Figure 5-11. Create WBS: Data Flow Diagram

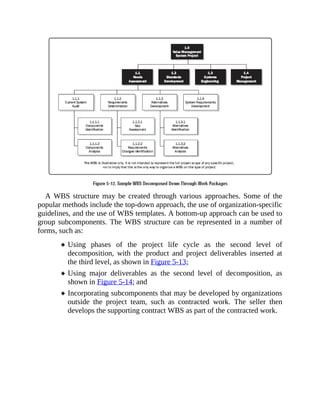

Figure 5-12. Sample WBS Decomposed Down Through Work
Packages
Figure 5-13. Sample WBS Organized by Phase
Figure 5-14. Sample WBS with Major Deliverables
Figure 5-15. Validate Scope: Inputs, Tools & Techniques, and
Outputs
Figure 5-16. Validate Scope: Data Flow Diagram
Figure 5-17. Control Scope: Inputs, Tools & Techniques, and
Outputs
Figure 5-18. Control Scope: Data Flow Diagram
Figure 6-1. Project Schedule Management Overview
Figure 6-2. Scheduling Overview
Figure 6-3. Plan Schedule Management: Inputs, Tools &
Techniques, and Outputs
Figure 6-4. Plan Schedule Management: Data Flow Diagram
Figure 6-5. Define Activities: Inputs, Tools & Techniques, and
Outputs
Figure 6-6. Define Activities: Data Flow Diagram
Figure 6-7. Sequence Activities: Inputs, Tools & Techniques, and
Outputs
Figure 6-8. Sequence Activities: Data Flow Diagram
Figure 6-9. Precedence Diagramming Method (PDM) Relationship
Types
Figure 6-10. Examples of Lead and Lag
Figure 6-11. Project Schedule Network Diagram
Figure 6-12. Estimate Activity Durations: Inputs, Tools &
Techniques, and Outputs
Figure 6-13. Estimate Activity Durations: Data Flow Diagram
Figure 6-14. Develop Schedule: Inputs, Tools & Techniques, and
Outputs
Figure 6-15. Develop Schedule: Data Flow Diagram

Figure 6-16. Example of Critical Path Method
Figure 6-17. Resource Leveling
Figure 6-18. Example Probability Distribution of a Target Milestone
Figure 6-19. Schedule Compression Comparison
Figure 6-20. Relationship Between Product Vision, Release
Planning, and Iteration Planning
Figure 6-21. Project Schedule Presentations—Examples
Figure 6-22. Control Schedule: Inputs, Tools & Techniques, and
Outputs
Figure 6-23. Control Schedule: Data Flow Diagram

Figure 6-24. Iteration Burndown Chart

Figure 7-1. Project Cost Management Overview
Figure 7-2. Plan Cost Management: Inputs, Tools & Techniques,
and Outputs
Figure 7-3. Plan Cost Management: Data Flow Diagram
Figure 7-4. Estimate Costs: Inputs, Tools & Techniques, and
Outputs
Figure 7-5. Estimate Costs: Data Flow Diagram
Figure 7-6. Determine Budget: Inputs, Tools & Techniques, and
Outputs
Figure 7-7. Determine Budget: Data Flow Diagram
Figure 7-8. Project Budget Components
Figure 7-9. Cost Baseline, Expenditures, and Funding
Requirements
Figure 7-10. Control Costs: Inputs, Tools & Techniques, and
Outputs
Figure 7-11. Control Costs: Data Flow Diagram
Figure 7-12. Earned Value, Planned Value, and Actual Costs
Figure 7-13. To-Complete Performance Index (TCPI)
Figure 8-1. Project Quality Management Overview
Figure 8-2. Major Project Quality Management Process
Interrelations
Figure 8-3. Plan Quality Management: Inputs, Tools &
Techniques, and Outputs
Figure 8-4. Plan Quality Management: Data Flow Diagram
Figure 8-5. Cost of Quality
Figure 8-6. The SIPOC Model
Figure 8-7. Manage Quality: Inputs, Tools & Techniques, and
Outputs
Figure 8-8. Manage Quality: Data Flow Diagram
Figure 8-9. Cause-and-Effect Diagram
Figure 8-10. Control Quality: Inputs, Tools & Techniques, and
Outputs
Figure 8-11. Control Quality: Data Flow Diagram
Figure 8-12. Check Sheets
Figure 9-1. Project Resource Management Overview
Figure 9-2. Plan Resource Management: Inputs, Tools &
Techniques, and Outputs
Figure 9-3. Plan Resource Management: Data Flow Diagram
Figure 9-4. Sample RACI Chart
Figure 9-5. Estimate Activity Resources: Inputs, Tools &
Techniques, and Outputs
Figure 9-6. Estimate Activity Resources: Data Flow Diagram
Figure 9-7. Sample Resource Breakdown Structure
Figure 9-8. Acquire Resources: Inputs, Tools & Techniques, and
Outputs
Figure 9-9. Acquire Resources: Data Flow Diagram
Figure 9-10. Develop Team: Inputs, Tools & Techniques, and
Outputs
Figure 9-11. Develop Team: Data Flow Diagram
Figure 9-12. Manage Team: Inputs, Tools & Techniques, and
Outputs
Figure 9-13. Manage Team: Data Flow Diagram
Figure 9-14. Control Resources: Inputs, Tools & Techniques, and
Outputs
Figure 9-15. Control Resources: Data Flow Diagram
Figure 10-1. Project Communications Overview
Figure 10-2. Plan Communications Management: Inputs, Tools &
Techniques, and Outputs

Figure 10-3. Plan Communications Management: Data Flow
Diagram
Figure 10-4. Communication Model for Cross-Cultural
Communication
Figure 10-5. Manage Communications: Inputs, Tools & Techniques,
and Outputs
Figure 10-6. Manage Communications: Data Flow Diagram
Figure 10-7. Monitor Communications: Inputs, Tools & Techniques,
and Outputs
Figure 10-8. Monitor Communications: Data Flow Diagram

Figure 11-1. Project Risk Management Overview
Figure 11-2. Plan Risk Management: Inputs, Tools & Techniques,
and Outputs
Figure 11-3. Plan Risk Management: Data Flow Diagram
Figure 11-4. Extract from Sample Risk Breakdown Structure (RBS)

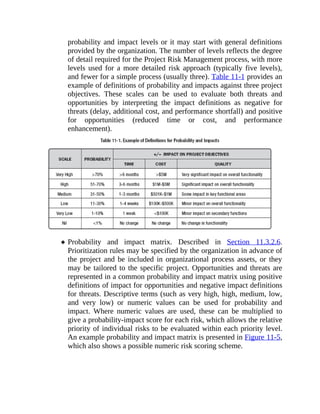

Figure 11-5. Example Probability and Impact Matrix with Scoring
Scheme
Figure 11-6. Identify Risks: Inputs, Tools & Techniques, and
Outputs
Figure 11-7. Identify Risks: Data Flow Diagram
Figure 11-8. Perform Qualitative Risk Analysis: Inputs, Tools &
Techniques, and Outputs
Figure 11-9. Perform Qualitative Risk Analysis: Data Flow Diagram
Figure 11-10. Example Bubble Chart Showing Detectability,
Proximity, and Impact Value
Figure 11-11. Perform Quantitative Risk Analysis: Inputs, Tools &
Techniques, and Outputs
Figure 11-12. Perform Quantitative Risk Analysis: Data Flow
Diagram
Figure 11-13. Example S-Curve from Quantitative Cost Risk
Analysis
Figure 11-14. Example Tornado Diagram
Figure 11-15. Example Decision Tree
Figure 11-16. Plan Risk Responses: Inputs, Tools & Techniques, and
Outputs
Figure 11-17. Plan Risk Responses: Data Flow Diagram
Figure 11-18. Implement Risk Responses: Inputs, Tools &
Techniques, and Outputs
Figure 11-19. Implement Risk Responses: Data Flow Diagram
Figure 11-20. Monitor Risks: Inputs, Tools & Techniques, and
Outputs
Figure 11-21. Monitor Risks: Data Flow Diagram
Figure 12-1. Project Procurement Management Overview
Figure 12-2. Plan Procurement Management: Inputs, Tools &
Techniques, and Outputs
Figure 12-3. Plan Procurement Management: Data Flow Diagram
Figure 12-4. Conduct Procurements: Inputs, Tools & Techniques,
and Outputs
Figure 12-5. Conduct Procurements: Data Flow Diagram
Figure 12-6. Control Procurements: Inputs, Tools & Techniques,
and Outputs
Figure 12-7. Control Procurements: Data Flow Diagram
Figure 13-1. Project Stakeholder Management Overview
Figure 13-2. Identify Stakeholders: Inputs, Tools & Techniques, and
Outputs
Figure 13-3. Identify Stakeholders: Data Flow Diagram
Figure 13-4. Plan Stakeholder Engagement: Inputs, Tools &
Techniques, and Outputs
Figure 13-5. Plan Stakeholder Engagement: Data Flow Diagram
Figure 13-6. Stakeholder Engagement Assessment Matrix
Figure 13-7. Manage Stakeholder Engagement: Inputs, Tools &
Techniques, and Outputs
Figure 13-8. Manage Stakeholder Engagement: Data Flow Diagram
Figure 13-9. Monitor Stakeholder Engagement: Inputs, Tools &
Techniques, and Outputs
Figure 13-10. Monitor Stakeholder Engagement: Data Flow Diagram

Table 1-1. Examples of Factors that Lead to the Creation of a
Project
Table 1-2. Comparative Overview of Portfolios, Programs, and
Projects
Table 1-3. Description of PMBOK® Guide Key Components
Table 1-4. Project Management Process Group and Knowledge
Area Mapping
Table 1-5. Project Business Documents
Table 2-1. Influences of Organizational Structures on Projects
Table 3-1. Team Management and Team Leadership Compared
Table 4-1. Project Management Plan and Project Documents
Table 5-1. Elements of the Project Charter and Project Scope
Statement
Table 7-1. Earned Value Calculations Summary Table
Table 11-1. Example of Definitions for Probability and Impacts
Table 12-1. Comparison of Procurement Documentation
PART 2.
The Standard For Project Management
Figure 1-1. Example of Portfolio, Program, and Project
Management Interfaces
Figure 1-2. Generic Depiction of a Project Life Cycle
Figure 1-3. Impact of Variables Over Time
Figure 1-4. Examples of Project Stakeholders
Figure 1-5. Example of Process Group Interactions Within a
Project or Phase
Figure 2-1. Project Boundaries
Figure 2-2. Initiating Process Group
Figure 2-3. Develop Project Charter: Inputs and Outputs
Figure 2-4. Identify Stakeholders: Inputs and Outputs
Figure 3-1. Planning Process Group
Figure 3-2. Develop Project Management Plan: Inputs and Outputs
Figure 3-3. Plan Scope Management: Inputs and Outputs
Figure 3-4. Collect Requirements: Inputs and Outputs
Figure 3-5. Define Scope: Inputs and Outputs
Figure 3-6. Create WBS: Inputs and Outputs
Figure 3-7. Plan Schedule Management: Inputs and Outputs
Figure 3-8. Define Activities: Inputs and Outputs
Figure 3-9. Sequence Activities: Inputs and Outputs
Figure 3-10. Estimate Activity Durations: Inputs and Outputs
Figure 3-11. Develop Schedule: Inputs and Outputs
Figure 3-12. Plan Cost Management: Inputs and Outputs
Figure 3-13. Estimate Costs: Inputs and Outputs
Figure 3-14. Determine Budget: Inputs and Outputs
Figure 3-15. Plan Quality Management: Inputs and Outputs
Figure 3-16. Plan Resource Management: Inputs and Outputs
Figure 3-17. Estimate Activity Resources: Inputs and Outputs
Figure 3-18. Plan Communications Management: Inputs and
Outputs
Figure 3-19. Plan Risk Management: Inputs and Outputs
Figure 3-20. Identify Risks: Inputs and Outputs
Figure 3-21. Perform Qualitative Risk Analysis: Inputs and Outputs
Figure 3-22. Perform Quantitative Risk Analysis: Inputs and
Outputs
Figure 3-23. Plan Risk Responses: Inputs and Outputs
Figure 3-24. Plan Procurement Management: Inputs and Outputs
Figure 3-25. Plan Stakeholder Engagement: Inputs and Outputs
Figure 4-1. Executing Process Group
Figure 4-2. Direct and Manage Project Work: Inputs and Outputs
Figure 4-3. Manage Project Knowledge: Inputs and Outputs
Figure 4-4. Manage Quality: Inputs and Outputs
Figure 4-5. Acquire Resources: Inputs and Outputs
Figure 4-6. Develop Team: Inputs and Outputs
Figure 4-7. Manage Team: Inputs and Outputs
Figure 4-8. Manage Communications: Inputs and Outputs
Figure 4-9. Implement Risk Responses: Inputs and Outputs
Figure 4-10. Conduct Procurements: Inputs and Outputs
Figure 4-11. Manage Stakeholder Engagement: Inputs and Outputs
Figure 5-1. Monitoring and Controlling Process Group
Figure 5-2. Monitor and Control Project Work: Inputs and Outputs
Figure 5-3. Perform Integrated Change Control: Inputs and
Outputs
Figure 5-4. Validate Scope: Inputs and Outputs
Figure 5-5. Control Scope: Inputs and Outputs
Figure 5-6. Control Schedule: Inputs and Outputs
Figure 5-7. Control Costs: Inputs and Outputs
Figure 5-8. Control Quality: Inputs and Outputs
Figure 5-9. Control Resources: Inputs and Outputs
Figure 5-10. Monitor Communications: Inputs and Outputs
Figure 5-11. Monitor Risks: Inputs and Outputs
Figure 5-12. Control Procurements: Inputs and Outputs
Figure 5-13. Monitor Stakeholder Engagement: Inputs and Outputs
Figure 6-1. Closing Process Group
Figure 6-2. Close Project or Phase: Inputs and Outputs
Table 1-1. Project Management Process Group and Knowledge
Area Mapping
Table 1-2. Project Management Plan and Project Documents
PART 3.
APPENDICES, GLOSSARY, AND INDEX
Figure X3-1. The Continuum of Project Life Cycles
Figure X3-2. Level of Effort for Process Groups across Iteration
Cycles
Figure X3-3. Relationship of Process Groups in Continuous Phases
Table X1-1. Section 4 Changes
Table X1-2. Section 6 Changes
Table X1-3. Section 8 Changes
Table X1-4. Section 9 Changes
Table X1-5. Section 10 Changes
Table X1-6. Section 11 Changes
Table X1-7. Section 12 Changes
Table X1-8. Section 13 Changes
Table X6-1. Categorization and Index of Tools and Techniques
Part 1
A Guide to the Project Management
Body of Knowledge
(PMBOK® GUIDE)
The information contained in this part is not an American National Standard (ANS) and has not been
processed in accordance with ANSI's requirements for an ANS. As such, the information in this part may
contain material that has not been subjected to public review or a consensus process. In addition, it does not
contain requirements necessary for conformance to an ANS standard.
1
INTRODUCTION
1.1 OVERVIEW AND PURPOSE OF THIS GUIDE
Project management is not new. It has been in use for hundreds of years.
Examples of project outcomes include:
Pyramids of Giza,
Olympic games,
Great Wall of China,
Taj Mahal,
Publication of a children's book,
Panama Canal,
Development of commercial jet airplanes,
Polio vaccine,
Human beings landing on the moon,
Commercial software applications,
Portable devices to use the global positioning system (GPS), and
Placement of the International Space Station into Earth's orbit.
The outcomes of these projects were the result of leaders and managers
applying project management practices, principles, processes, tools, and
techniques to their work. The managers of these projects used a set of key skills
and applied knowledge to satisfy their customers and other people involved in
and affected by the project. By the mid-20th century, project managers began the
work of seeking recognition for project management as a profession. One aspect
of this work involved obtaining agreement on the content of the body of
knowledge (BOK) called project management. This BOK became known as the
Project Management Body of Knowledge (PMBOK). The Project Management
Institute (PMI) produced a baseline of charts and glossaries for the PMBOK.
Project managers soon realized that no single book could contain the entire
PMBOK. Therefore, PMI developed and published A Guide to the Project
Management Body of Knowledge (PMBOK® Guide).
PMI defines the project management body of knowledge (PMBOK) as a term
that describes the knowledge within the profession of project management. The
project management body of knowledge includes proven traditional practices
that are widely applied as well as innovative practices that are emerging in the
profession.
The body of knowledge (BOK) includes both published and unpublished
materials. This body of knowledge is constantly evolving. This PMBOK®
Guide identifies a subset of the project management body of knowledge that is
generally recognized as good practice.
Generally recognized means the knowledge and practices described
are applicable to most projects most of the time, and there is consensus
about their value and usefulness.
Good practice means there is general agreement that the application of
the knowledge, skills, tools, and techniques to project management
processes can enhance the chance of success over many projects in
delivering the expected business values and results.
The project manager works with the project team and other stakeholders to
determine and use the appropriate generally recognized good practices for each
project. Determining the appropriate combination of processes, inputs, tools,
techniques, outputs and life cycle phases to manage a project is referred to as
“tailoring” the application of the knowledge described in this guide.
This PMBOK® Guide is different from a methodology. A methodology is a
system of practices, techniques, procedures, and rules used by those who work in
a discipline. This PMBOK® Guide is a foundation upon which organizations
can build methodologies, policies, procedures, rules, tools and techniques, and
life cycle phases needed to practice project management.
1.1.1 THE STANDARD FOR PROJECT MANAGEMENT
This guide is based on The Standard for Project Management [1]. A standard
is a document established by an authority, custom, or general consent as a model
or example. As an American National Standards Institute (ANSI) standard, The
Standard for Project Management was developed using a process based on the
concepts of consensus, openness, due process, and balance. The Standard for
Project Management is a foundational reference for PMI's project management
professional development programs and the practice of project management.
Because project management needs to be tailored to fit the needs of the project,
the standard and the guide are both based on descriptive practices, rather than
prescriptive practices. Therefore, the standard identifies the processes that are
considered good practices on most projects, most of the time. The standard also
identifies the inputs and outputs that are usually associated with those processes.
The standard does not require that any particular process or practice be
performed. The Standard for Project Management is included as Part II of A
Guide to the Project Management Body of Knowledge (PMBOK® Guide).
The PMBOK® Guide provides more detail about key concepts, emerging
trends, considerations for tailoring the project management processes, and
information on how tools and techniques are applied to projects. Project
managers may use one or more methodologies to implement the project
management processes outlined in the standard.
The scope of this guide is limited to the discipline of project management,
rather than the full spectrum of portfolios, programs, and projects. Portfolios and
programs will be addressed only to the degree they interact with projects. PMI
publishes two other standards that address the management of portfolios and
programs:
The Standard for Portfolio Management [2], and
The Standard for Program Management [3].
1.1.2 COMMON VOCABULARY
A common vocabulary is an essential element of a professional discipline.
The PMI Lexicon of Project Management Terms [4] provides the foundational
professional vocabulary that can be consistently used by organizations, portfolio,
program, and project managers and other project stakeholders. The Lexicon will
continue to evolve over time. The glossary to this guide includes the vocabulary
in the Lexicon along with additional definitions. There may be other industry-
specific terms used in projects that are defined by that industry's literature.
1.1.3 CODE OF ETHICS AND PROFESSIONAL CONDUCT
PMI publishes the Code of Ethics and Professional Conduct [5] to instill
confidence in the project management profession and to help an individual in
making wise decisions, particularly when faced with difficult situations where
the individual may be asked to compromise his or her integrity or values. The
values that the global project management community defined as most important
were responsibility, respect, fairness, and honesty. The Code of Ethics and
Professional Conduct affirms these four values as its foundation.
The Code of Ethics and Professional Conduct includes both aspirational
standards and mandatory standards. The aspirational standards describe the
conduct that practitioners, who are also PMI members, certification holders, or
volunteers, strive to uphold. Although adherence to the aspirational standards is
not easily measured, conduct in accordance with these is an expectation for those
who consider themselves to be professionals—it is not optional. The mandatory
standards establish firm requirements and, in some cases, limit or prohibit
practitioner behavior. Practitioners who are also PMI members, certification
holders, or volunteers and who do not conduct themselves in accordance with
these standards will be subject to disciplinary procedures before PMI's Ethics
Review Committee.
1.2 FOUNDATIONAL ELEMENTS
This section describes foundational elements necessary for working in and
understanding the discipline of project management.
1.2.1 PROJECTS
A project is a temporary endeavor undertaken to create a unique product,
service, or result.
Unique product, service, or result. Projects are undertaken to fulfill
objectives by producing deliverables. An objective is defined as an
outcome toward which work is to be directed, a strategic position to be
attained, a purpose to be achieved, a result to be obtained, a product to
be produced, or a service to be performed. A deliverable is defined as
any unique and verifiable product, result, or capability to perform a
service that is required to be produced to complete a process, phase, or
project. Deliverables may be tangible or intangible.
Fulfillment of project objectives may produce one or more of the following
deliverables:
A unique product that can be either a component of another item, an
enhancement or correction to an item, or a new end item in itself
(e.g., the correction of a defect in an end item);
A unique service or a capability to perform a service (e.g., a business
function that supports production or distribution);
A unique result, such as an outcome or document (e.g., a research
project that develops knowledge that can be used to determine
whether a trend exists or a new process will benefit society); and
A unique combination of one or more products, services, or results
(e.g., a software application, its associated documentation, and help
desk services).
Repetitive elements may be present in some project deliverables and
activities. This repetition does not change the fundamental and unique
characteristics of the project work. For example, office buildings can be
constructed with the same or similar materials and by the same or different
teams. However, each building project remains unique in key
characteristics (e.g., location, design, environment, situation, people
involved).
Projects are undertaken at all organizational levels. A project can involve a
single individual or a group. A project can involve a single organizational
unit or multiple organizational units from multiple organizations.
Examples of projects include but are not limited to:
Developing a new pharmaceutical compound for market,
Expanding a tour guide service,
Merging two organizations,
Improving a business process within an organization,
Acquiring and installing a new computer hardware system for use in
an organization,
Exploring for oil in a region,
Modifying a computer software program used in an organization,
Conducting research to develop a new manufacturing process, and
Constructing a building.
Temporary endeavor. The temporary nature of projects indicates that a
project has a definite beginning and end. Temporary does not
necessarily mean a project has a short duration. The end of the project
is reached when one or more of the following is true:
The project's objectives have been achieved;
The objectives will not or cannot be met;
Funding is exhausted or no longer available for allocation to the
project;
The need for the project no longer exists (e.g., the customer no longer
wants the project completed, a change in strategy or priority ends the
project, the organizational management provides direction to end the
project);
The human or physical resources are no longer available; or
The project is terminated for legal cause or convenience.
Projects are temporary, but their deliverables may exist beyond the end of
the project. Projects may produce deliverables of a social, economic,
material, or environmental nature. For example, a project to build a national
monument will create a deliverable expected to last for centuries.
Projects drive change. Projects drive change in organizations. From a
business perspective, a project is aimed at moving an organization
from one state to another state in order to achieve a specific objective
(see Figure 1-1). Before the project begins, the organization is
commonly referred to as being in the current state. The desired result
of the change driven by the project is described as the future state.
For some projects, this may involve creating a transition state where
multiple steps are made along a continuum to achieve the future state.
The successful completion of a project results in the organization
moving to the future state and achieving the specific objective. For
more information on project management and change, see Managing
Change in Organizations: A Practice Guide [6].
Projects enable business value creation. PMI defines business value as
the net quantifiable benefit derived from a business endeavor. The
benefit may be tangible, intangible, or both. In business analysis,
business value is considered the return, in the form of elements such as
time, money, goods, or intangibles in return for something exchanged
(see Business Analysis for Practitioners: A Practice Guide, p. 185
[7]).
Business value in projects refers to the benefit that the results of a specific
project provide to its stakeholders. The benefit from projects may be
tangible, intangible, or both.
Examples of tangible elements include:
Monetary assets,
Stockholder equity,
Utility,
Fixtures,
Tools, and
Market share.
Examples of intangible elements include:
Goodwill,
Brand recognition,
Public benefit,
Trademarks,
Strategic alignment, and
Reputation.
Project Initiation Context. Organizational leaders initiate projects in
response to factors acting upon their organizations. There are four
fundamental categories for these factors, which illustrate the context of
a project (see Figure 1-2):
Meet regulatory, legal, or social requirements;
Satisfy stakeholder requests or needs;
Implement or change business or technological strategies; and
Create, improve, or fix products, processes, or services.
These factors influence an organization's ongoing operations and business
strategies. Leaders respond to these factors in order to keep the organization
viable. Projects provide the means for organizations to successfully make the
changes necessary to deal with these factors. These factors ultimately should link
to the strategic objectives of the organization and the business value of each
project.
1.2.2 THE IMPORTANCE OF PROJECT MANAGEMENT
Project management is the application of knowledge, skills, tools, and
techniques to project activities to meet the project requirements. Project
management is accomplished through the appropriate application and integration
of the project management processes identified for the project. Project
management enables organizations to execute projects effectively and
efficiently.
Effective project management helps individuals, groups, and public and
private organizations to:
Meet business objectives;
Satisfy stakeholder expectations;
Be more predictable;
Increase chances of success;
Deliver the right products at the right time;
Resolve problems and issues;
Respond to risks in a timely manner;
Optimize the use of organizational resources;
Identify, recover, or terminate failing projects;
Manage constraints (e.g., scope, quality, schedule, costs, resources);
Balance the influence of constraints on the project (e.g., increased
scope may increase cost or schedule); and
Manage change in a better manner.
Poorly managed projects or the absence of project management may result
in:
Missed deadlines,
Cost overruns,
Poor quality,
Rework,
Uncontrolled expansion of the project,
Loss of reputation for the organization,
Unsatisfied stakeholders, and
Failure in achieving the objectives for which the project was
undertaken.
Projects are a key way to create value and benefits in organizations. In today's
business environment, organizational leaders need to be able to manage with
tighter budgets, shorter timelines, scarcity of resources, and rapidly changing
technology. The business environment is dynamic with an accelerating rate of
change. To remain competitive in the world economy, companies are embracing
project management to consistently deliver business value.
Effective and efficient project management should be considered a strategic
competency within organizations. It enables organizations to:
Tie project results to business goals,
Compete more effectively in their markets,
Sustain the organization, and
Respond to the impact of business environment changes on projects by
appropriately adjusting project management plans (see Section 4.2).
1.2.3 RELATIONSHIP OF PROJECT, PROGRAM, PORTFOLIO,
AND OPERATIONS MANAGEMENT
1.2.3.1 OVERVIEW
Using project management processes, tools, and techniques puts in place a
sound foundation for organizations to achieve their goals and objectives. A
project may be managed in three separate scenarios: as a stand-alone project
(outside of a portfolio or program), within a program, or within a portfolio.
Project managers interact with portfolio and program managers when a project is
within a program or portfolio. For example, multiple projects may be needed to
accomplish a set of goals and objectives for an organization. In those situations,
projects may be grouped together into a program. A program is defined as a
group of related projects, subsidiary programs, and program activities managed
in a coordinated manner to obtain benefits not available from managing them
individually. Programs are not large projects. A very large project may be
referred to as a megaproject. As a guideline, megaprojects cost US$1billion or
more, affect 1 million or more people, and run for years.
Some organizations may employ the use of a project portfolio to effectively
manage multiple programs and projects that are underway at any given time. A
portfolio is defined as projects, programs, subsidiary portfolios, and operations
managed as a group to achieve strategic objectives. Figure 1-3 illustrates an
example of how portfolios, programs, projects, and operations are related in a
specific situation.
Program management and portfolio management differ from project
management in their life cycles, activities, objectives, focus, and benefits.
However, portfolios, programs, projects, and operations often engage with the
same stakeholders and may need to use the same resources (see Figure 1-3),
which may result in a conflict in the organization. This type of a situation
increases the need for coordination within the organization through the use of
portfolio, program, and project management to achieve a workable balance in
the organization.
Figure 1-3 illustrates a sample portfolio structure indicating relationships
between the programs, projects, shared resources, and stakeholders. The
portfolio components are grouped together in order to facilitate the effective
governance and management of the work that helps to achieve organizational
strategies and priorities. Organizational and portfolio planning impact the
components by means of prioritization based on risk, funding, and other
considerations. The portfolio view allows organizations to see how the strategic
goals are reflected in the portfolio. This portfolio view also enables the
implementation and coordination of appropriate portfolio, program, and project
governance. This coordinated governance allows authorized allocation of
human, financial, and physical resources based on expected performance and
benefits.
Looking at project, program, and portfolio management from an
organizational perspective:
Program and project management focus on doing programs and
projects the “right” way; and
Portfolio management focuses on doing the “right” programs and
projects.
Table 1-2 gives a comparative overview of portfolios, programs, and projects.
1.2.3.2 PROGRAM MANAGEMENT
Program management is defined as the application of knowledge, skills, and
principles to a program to achieve the program objectives and to obtain benefits
and control not available by managing program components individually. A
program component refers to projects and other programs within a program.
Project management focuses on interdependencies within a project to determine
the optimal approach for managing the project. Program management focuses on
the interdependencies between projects and between projects and the program
level to determine the optimal approach for managing them. Actions related to
these program and project-level interdependencies may include:
Aligning with the organizational or strategic direction that affects
program and project goals and objectives;
Allocating the program scope into program components;
Managing interdependencies among the components of the program to
best serve the program;
Managing program risks that may impact multiple projects in the
program;
Resolving constraints and conflicts that affect multiple projects within
the program;
Resolving issues between component projects and the program level;
Managing change requests within a shared governance framework;
Allocating budgets across multiple projects within the program; and
Assuring benefits realization from the program and component
projects.
An example of a program is a new communications satellite system with
projects for the design and construction of the satellite and the ground stations,
the launch of the satellite, and the integration of the system.
For more information on program management, see The Standard for
Program Management [3].
1.2.3.3 PORTFOLIO MANAGEMENT
A portfolio is defined as projects, programs, subsidiary portfolios, and
operations managed as a group to achieve strategic objectives.
Portfolio management is defined as the centralized management of one or
more portfolios to achieve strategic objectives. The programs or projects of the
portfolio may not necessarily be interdependent or directly related.
The aim of portfolio management is to:
Guide organizational investment decisions.
Select the optimal mix of programs and projects to meet strategic
objectives.
Provide decision-making transparency.
Prioritize team and physical resource allocation.
Increase the likelihood of realizing the desired return on investment.
Centralize the management of the aggregate risk profile of all
components.
Portfolio management also confirms that the portfolio is consistent with and
aligned with organizational strategies.
Maximizing the value of the portfolio requires careful examination of the
components that comprise the portfolio. Components are prioritized so that those
contributing the most to the organization's strategic objectives have the required
financial, team, and physical resources.
For example, an infrastructure organization that has the strategic objective of
maximizing the return on its investments may put together a portfolio that
includes a mix of projects in oil and gas, power, water, roads, rail, and airports.
From this mix, the organization may choose to manage related projects as one
portfolio. All of the power projects may be grouped together as a power
portfolio. Similarly, all of the water projects may be grouped together as a water
portfolio. However, when the organization has projects in designing and
constructing a power plant and then operates the power plant to generate energy,
those related projects can be grouped in one program. Thus, the power program
and similar water program become integral components of the portfolio of the
infrastructure organization.
For more information on portfolio management, see The Standard for
Portfolio Management [2].
1.2.3.4 OPERATIONS MANAGEMENT
Operations management is an area that is outside the scope of formal project
management as described in this guide.
Operations management is concerned with the ongoing production of goods
and/or services. It ensures that business operations continue efficiently by using
the optimal resources needed to meet customer demands. It is concerned with
managing processes that transform inputs (e.g., materials, components, energy,
and labor) into outputs (e.g., products, goods, and/or services).
1.2.3.5 OPERATIONS AND PROJECT MANAGEMENT
Changes in business or organizational operations may be the focus of a project
—especially when there are substantial changes to business operations as a result
of a new product or service delivery. Ongoing operations are outside of the
scope of a project; however, there are intersecting points where the two areas
cross.
Projects can intersect with operations at various points during the product life
cycle, such as;
When developing a new product, upgrading a product, or expanding
outputs;
While improving operations or the product development process;
At the end of the product life cycle; and
At each closeout phase.
At each point, deliverables and knowledge are transferred between the project
and operations for implementation of the delivered work. This implementation
occurs through a transfer of project resources or knowledge to operations or
through a transfer of operational resources to the project.
1.2.3.6 ORGANIZATIONAL PROJECT MANAGEMENT (OPM) AND
STRATEGIES
Portfolios, programs, and projects are aligned with or driven by organizational
strategies and differ in the way each contributes to the achievement of strategic
goals:
Portfolio management aligns portfolios with organizational strategies
by selecting the right programs or projects, prioritizing the work, and
providing the needed resources.
Program management harmonizes its program components and
controls interdependencies in order to realize specified benefits.
Project management enables the achievement of organizational goals
and objectives.
Within portfolios or programs, projects are a means of achieving
organizational goals and objectives. This is often accomplished in the context of
a strategic plan that is the primary factor guiding investments in projects.
Alignment with the organization's strategic business goals can be achieved
through the systematic management of portfolios, programs, and projects
through the application of organizational project management (OPM). OPM is
defined as a framework in which portfolio, program, and project management
are integrated with organizational enablers in order to achieve strategic
objectives.
The purpose of OPM is to ensure that the organization undertakes the right
projects and allocates critical resources appropriately. OPM also helps to ensure
that all levels in the organization understand the strategic vision, the initiatives
that support the vision, the objectives, and the deliverables. Figure 1-4 shows the
organizational environment where strategy, portfolio, programs, projects, and
operations interact.
For more information on OPM, refer to Implementing Organizational Project
Management: A Practice Guide [8].
1.2.4 COMPONENTS OF THE GUIDE
Projects comprise several key components that, when effectively managed,
result in their successful completion. This guide identifies and explains these
components. The various components interrelate to one another during the
management of a project.
The key components are described briefly in Table 1-3. These components are
more fully explained in the sections that follow the table.
Table 1-3. Description of PMBOK® Guide Key Components
PMBOK® Guide Key Component Brief Description
Project life cycle (Section 1.2.4.1) The series of phases that a project passes through from its
start to its completion.
Project phase (Section 1.2.4.2) A collection of logically related project activities that
culminates in the completion of one or more deliverables.
Phase gate (Section 1.2.4.3) A review at the end of a phase in which a decision is made
to continue to the next phase, to continue with modification,
or to end a program or project.
Project management processes
(Section 1.2.4.4)
A systematic series of activities directed toward causing an
end result where one or more inputs will be acted upon to
create one or more outputs.
Project Management Process Group
(Section 1.2.4.5)
A logical grouping of project management inputs, tools and
techniques, and outputs. The Project Management Process
Groups include Initiating, Planning, Executing, Monitoring
and Controlling, and Closing. Project Management Process
Groups are not project phases.
Project Management Knowledge Area
(Section 1.2.4.6)
An identified area of project management defined by its
knowledge requirements and described in terms of its
component processes, practices, inputs, outputs, tools, and
techniques.
1.2.4.1 PROJECT AND DEVELOPMENT LIFE CYCLES
A project life cycle is the series of phases that a project passes through from
its start to its completion. It provides the basic framework for managing the
project. This basic framework applies regardless of the specific project work
involved. The phases may be sequential, iterative, or overlapping. All projects
can be mapped to the generic life cycle shown in Figure 1-5.
Project life cycles can be predictive or adaptive. Within a project life cycle,
there are generally one or more phases that are associated with the development
of the product, service, or result. These are called a development life cycle.
Development life cycles can be predictive, iterative, incremental, adaptive, or a
hybrid model:
In a predictive life cycle, the project scope, time, and cost are
determined in the early phases of the life cycle. Any changes to the
scope are carefully managed. Predictive life cycles may also be
referred to as waterfall life cycles.
In an iterative life cycle, the project scope is generally determined
early in the project life cycle, but time and cost estimates are routinely
modified as the project team's understanding of the product increases.
Iterations develop the product through a series of repeated cycles,
while increments successively add to the functionality of the product.
In an incremental life cycle, the deliverable is produced through a
series of iterations that successively add functionality within a
predetermined time frame. The deliverable contains the necessary and
sufficient capability to be considered complete only after the final
iteration.
Adaptive life cycles are agile, iterative, or incremental. The detailed
scope is defined and approved before the start of an iteration. Adaptive
life cycles are also referred to as agile or change-driven life cycles. See
Appendix X3.
A hybrid life cycle is a combination of a predictive and an adaptive
life cycle. Those elements of the project that are well known or have
fixed requirements follow a predictive development life cycle, and
those elements that are still evolving follow an adaptive development
life cycle.
It is up to the project management team to determine the best life cycle for
each project. The project life cycle needs to be flexible enough to deal with the
variety of factors included in the project. Life cycle flexibility may be
accomplished by:
Identifying the process or processes needed to be performed in each
phase,
Performing the process or processes identified in the appropriate
phase,
Adjusting the various attributes of a phase (e.g., name, duration, exit
criteria, and entrance criteria).
Project life cycles are independent of product life cycles, which may be
produced by a project. A product life cycle is the series of phases that represent
the evolution of a product, from concept through delivery, growth, maturity, and
to retirement.
1.2.4.2 PROJECT PHASE
A project phase is a collection of logically related project activities that
culminates in the completion of one or more deliverables. The phases in a life
cycle can be described by a variety of attributes. Attributes may be measurable
and unique to a specific phase. Attributes may include but are not limited to:
Name (e.g., Phase A, Phase B, Phase 1, Phase 2, proposal phase),
Number (e.g., three phases in the project, five phases in the project),
Duration (e.g., 1 week, 1 month, 1 quarter),
Resource requirements (e.g., people, buildings, equipment),
Entrance criteria for a project to move into that phase (e.g., specified
approvals documented, specified documents completed), and
Exit criteria for a project to complete a phase (e.g., documented
approvals, completed documents, completed deliverables).
Projects may be separated into distinct phases or subcomponents. These
phases or subcomponents are generally given names that indicate the type of
work done in that phase. Examples of phase names include but are not limited
to:
Concept development,
Feasibility study,
Customer requirements,
Solution development,
Design,
Prototype,
Build,
Test,
Transition,
Commissioning,
Milestone review, and
Lessons learned.
The project phases may be established based on various factors including, but
not limited to:
Management needs;
Nature of the project;
Unique characteristics of the organization, industry, or technology;
Project elements including, but not limited to, technology, engineering,
business, process, or legal; and
Decision points (e.g., funding, project go/no-go, and milestone
review).
Using multiple phases may provide better insight to managing the project. It
also provides an opportunity to assess the project performance and take
necessary corrective or preventive actions in subsequent phases. A key
component used with project phases is the phase review (see Section 1.2.4.3).
1.2.4.3 PHASE GATE
A phase gate, is held at the end of a phase. The project's performance and
progress are compared to project and business documents including but not
limited to:
Project business case (see Section 1.2.6.1),
Project charter (see Section 4.1),
Project management plan (see Section 4.2), and
Benefits management plan (see Section 1.2.6.2).
A decision (e.g., go/no-go decision) is made as a result of this comparison to:
Continue to the next phase,
Continue to the next phase with modification,
End the project,
Remain in the phase, or
Repeat the phase or elements of it.
Depending on the organization, industry, or type of work, phase gates may be
referred to by other terms such as, phase review, stage gate, kill point, and phase
entrance or phase exit. Organizations may use these reviews to examine other
pertinent items which are beyond the scope of this guide, such as product-related
documents or models.
1.2.4.4 PROJECT MANAGEMENT PROCESSES
The project life cycle is managed by executing a series of project management
activities known as project management processes. Every project management
process produces one or more outputs from one or more inputs by using
appropriate project management tools and techniques. The output can be a
deliverable or an outcome. Outcomes are an end result of a process. Project
management processes apply globally across industries.
Project management processes are logically linked by the outputs they
produce. Processes may contain overlapping activities that occur throughout the
project. The output of one process generally results in either:
An input to another process, or
A deliverable of the project or project phase.
Figure 1-6 shows an example of how inputs, tools and techniques, and outputs
relate to each other within a process, and with other processes.
The number of process iterations and interactions between processes varies
based on the needs of the project. Processes generally fall into one of three
categories:
Processes used once or at predefined points in the project. The
processes Develop Project Charter and Close Project or Phase are
examples.
Processes that are performed periodically as needed. The process
Acquire Resources is performed as resources are needed. The process
Conduct Procurements is performed prior to needing the procured
item.
Processes that are performed continuously throughout the project. The
process Define Activities may occur throughout the project life cycle,
especially if the project uses rolling wave planning or an adaptive
development approach. Many of the monitoring and control processes
are ongoing from the start of the project, until it is closed out.
Project management is accomplished through the appropriate application and
integration of logically grouped project management processes. While there are
different ways of grouping processes, the PMBOK® Guide groups processes
into five categories called Process Groups.
1.2.4.5 PROJECT MANAGEMENT PROCESS GROUPS
A Project Management Process Group is a logical grouping of project
management processes to achieve specific project objectives. Process Groups are
independent of project phases. Project management processes are grouped into
the following five Project Management Process Groups:
Initiating Process Group. Those processes performed to define a new
project or a new phase of an existing project by obtaining
authorization to start the project or phase.
Planning Process Group. Those processes required to establish the
scope of the project, refine the objectives, and define the course of
action required to attain the objectives that the project was undertaken
to achieve.
Executing Process Group. Those processes performed to complete the
work defined in the project management plan to satisfy the project
requirements.
Monitoring and Controlling Process Group. Those processes required
to track, review, and regulate the progress and performance of the
project; identify any areas in which changes to the plan are required;
and initiate the corresponding changes.
Closing Process Group. Those processes performed to formally
complete or close the project, phase, or contract.
Process flow diagrams are used throughout this guide. The project
management processes are linked by specific inputs and outputs where the result
or outcome of one process may become the input to another process that is not
necessarily in the same Process Group. Note that Process Groups are not the
same as project phases (see Section 1.2.4.2).
1.2.4.6 PROJECT MANAGEMENT KNOWLEDGE AREAS
In addition to Process Groups, processes are also categorized by Knowledge
Areas. A Knowledge Area is an identified area of project management defined
by its knowledge requirements and described in terms of its component
processes, practices, inputs, outputs, tools, and techniques.
Although the Knowledge Areas are interrelated, they are defined separately
from the project management perspective. The ten Knowledge Areas identified
in this guide are used in most projects most of the time. The ten Knowledge
Areas described in this guide are:
Project Integration Management. Includes the processes and activities
to identify, define, combine, unify, and coordinate the various
processes and project management activities within the Project
Management Process Groups.
Project Scope Management. Includes the processes required to ensure
the project includes all the work required, and only the work required,
to complete the project successfully.
Project Schedule Management. Includes the processes required to
manage the timely completion of the project.
Project Cost Management. Includes the processes involved in
planning, estimating, budgeting, financing, funding, managing, and
controlling costs so the project can be completed within the approved
budget.
Project Quality Management. Includes the processes for incorporating
the organization's quality policy regarding planning, managing, and
controlling project and product quality requirements, in order to meet
stakeholders’ expectations.
Project Resource Management. Includes the processes to identify,
acquire, and manage the resources needed for the successful
completion of the project.
Project Communications Management. Includes the processes required
to ensure timely and appropriate planning, collection, creation,
distribution, storage, retrieval, management, control, monitoring, and
ultimate disposition of project information.
Project Risk Management. Includes the processes of conducting risk
management planning, identification, analysis, response planning,
response implementation, and monitoring risk on a project.
Project Procurement Management. Includes the processes necessary to
purchase or acquire products, services, or results needed from outside
the project team.
Project Stakeholder Management. Includes the processes required to
identify the people, groups, or organizations that could impact or be
impacted by the project, to analyze stakeholder expectations and their
impact on the project, and to develop appropriate management
strategies for effectively engaging stakeholders in project decisions
and execution.
The needs of a specific project may require one or more additional Knowledge
Areas, for example, construction may require financial management or safety
and health management. Table 1-4 maps the Project Management Process
Groups and Knowledge Areas. Sections 4 through 13 provide more detail about
each Knowledge Area. This table is an overview of the basic processes described
in Sections 4 through 13.
1.2.4.7 PROJECT MANAGEMENT DATA AND INFORMATION
Throughout the life cycle of a project, a significant amount of data is
collected, analyzed, and transformed. Project data are collected as a result of
various processes and are shared within the project team. The collected data are
analyzed in context, aggregated, and transformed to become project information
during various processes. Information is communicated verbally or stored and
distributed in various formats as reports. See Section 4.3 for more detail on this
topic.
Project data are regularly collected and analyzed throughout the project life
cycle. The following definitions identify key terminology regarding project data
and information:
Work performance data. The raw observations and measurements
identified during activities performed to carry out the project work.
Examples include reported percent of work physically completed,
quality and technical performance measures, start and finish dates of
schedule activities, number of change requests, number of defects,
actual costs, actual durations, etc. Project data are usually recorded in a
Project Management Information System (PMIS) (see Section 4.3.2.2)
and in project documents.
Work performance information. The performance data collected from
various controlling processes, analyzed in context and integrated based
on relationships across areas. Examples of performance information
are status of deliverables, implementation status for change requests,
and forecast estimates to complete.
Work performance reports. The physical or electronic representation
of work performance information compiled in project documents,
which is intended to generate decisions or raise issues, actions, or
awareness. Examples include status reports, memos, justifications,
information notes, electronic dashboards, recommendations, and
updates.
Figure 1-7 shows the flow of project information across the various processes
used in managing the project.
1.2.5 TAILORING
Usually, project managers apply a project management methodology to their
work. A methodology is a system of practices, techniques, procedures, and rules
used by those who work in a discipline. This definition makes it clear that this
guide itself is not a methodology.
This guide and The Standard for Project Management [1] are recommended
references for tailoring, because these standard documents identify the subset of
the project management body of knowledge that is generally recognized as good
practice. “Good practice” does not mean that the knowledge described should
always be applied uniformly to all projects. Specific methodology
recommendations are outside the scope of this guide.
Project management methodologies may be:
Developed by experts within the organization,
Purchased from vendors,
Obtained from professional associations, or
Acquired from government agencies.
The appropriate project management processes, inputs, tools, techniques,
outputs, and life cycle phases should be selected to manage a project. This
selection activity is known as tailoring project management to the project. The
project manager collaborates with the project team, sponsor, organizational
management, or some combination thereof, in the tailoring. In some cases, the
organization may require specific project management methodologies be used.
Tailoring is necessary because each project is unique; not every process, tool,
technique, input, or output identified in the PMBOK® Guide is required on
every project. Tailoring should address the competing constraints of scope,
schedule, cost, resources, quality, and risk. The importance of each constraint is
different for each project, and the project manager tailors the approach for
managing these constraints based on the project environment, organizational
culture, stakeholder needs, and other variables.
In tailoring project management, the project manager should also consider the
varying levels of governance that may be required and within which the project
will operate, as well as considering the culture of the organization. In addition,
consideration of whether the customer of the project is internal or external to the
organization may affect project management tailoring decisions.
Sound project management methodologies take into account the unique nature
of projects and allow tailoring, to some extent, by the project manager. However,
the tailoring that is included in the methodology may still require additional
tailoring for a given project.
1.2.6 PROJECT MANAGEMENT BUSINESS DOCUMENTS
The project manager needs to ensure that the project management approach
captures the intent of business documents. These documents are defined in Table
1-5. These two documents are interdependent and iteratively developed and
maintained throughout the life cycle of the project.
Table 1-5. Project Business Documents
Project Business Documents Definition
Project business case A documented economic feasibility study used to establish
the validity of the benefits of a selected component lacking
sufficient definition and that is used as a basis for the
authorization of further project management activities.
Project benefits management plan The documented explanation defining the processes for
creating, maximizing, and sustaining the benefits provided
by a project.
The project sponsor is generally accountable for the development and
maintenance of the project business case document. The project manager is
responsible for providing recommendations and oversight to keep the project
business case, project management plan, project charter, and project benefits
management plan success measures in alignment with one another and with the
goals and objectives of the organization.
Project managers should appropriately tailor the noted project management
documents for their projects. In some organizations, the business case and
benefits management plan are maintained at the program level. Project managers
should work with the appropriate program managers to ensure the project
management documents are aligned with the program documents. Figure 1-8
illustrates the interrelationship of these critical project management business
documents and the needs assessment. Figure 1-8 shows an approximation of the
life cycle of these various documents against the project life cycle.
1.2.6.1 PROJECT BUSINESS CASE
The project business case is a documented economic feasibility study used to
establish the validity of the benefits of a selected component lacking sufficient
definition and that is used as a basis for the authorization of further project
management activities. The business case lists the objectives and reasons for
project initiation. It helps measure the project success at the end of the project
against the project objectives. The business case is a project business document
that is used throughout the project life cycle. The business case may be used
before the project initiation and may result in a go/no-go decision for the project.
A needs assessment often precedes the business case. The needs assessment
involves understanding business goals and objectives, issues, and opportunities
and recommending proposals to address them. The results of the needs
assessment may be summarized in the business case document.
The process of defining the business need, analyzing the situation, making
recommendations, and defining evaluation criteria is applicable to any
organization's projects. A business case may include but is not limited to
documenting the following:
Business needs:
Determination of what is prompting the need for action;
Situational statement documenting the business problem or
opportunity to be addressed including the value to be delivered to the
organization;
Identification of stakeholders affected; and
Identification of the scope.
Analysis of the situation:
Identification of organizational strategies, goals, and objectives;
Identification of root cause(s) of the problem or main contributors of
an opportunity;
Gap analysis of capabilities needed for the project versus existing
capabilities of the organization;
Identification of known risks;
Identification of critical success factors;
Identification of decision criteria by which the various courses of
action may be assessed;
Examples of criteria categories used for analysis of a situation are:
Required. This is a criterion that is “required” to be fulfilled to
address the problem or opportunity.
Desired. This is a criterion that is “desired” to be fulfilled to
address the problem or opportunity.
Optional. This is a criterion that is not essential. Fulfillment of
this criterion may become a differentiator between alternative
courses of action.
Identification of a set of options to be considered for addressing the
business problem or opportunity. Options are alternative courses of
action that may be taken by the organization. Options may also be
described as business scenarios. For example, a business case could
present the following three options:
Do nothing. This is also referred to as the “business as usual”
option. Selection of this option results in the project not being
authorized.
Do the minimum work possible to address the problem or
opportunity. The minimum may be established by identifying the
set of documented criteria that are key in addressing the problem
or opportunity.
Do more than the minimum work possible to address the
problem or opportunity. This option meets the minimum set of
criteria and some or all of the other documented criteria. There
may be more than one of these options documented in the
business case.
Recommendation:
A statement of the recommended option to pursue in the project;
Items to include in the statement may include but are not limited to:
Analysis results for the potential option;
Constraints, assumptions, risks, and dependencies for the
potential options; and
Success measures (see Section 1.2.6.4).
An implementation approach that may include but is not limited to:
Milestones,
Dependencies, and
Roles and responsibilities.
Evaluation:
Statement describing the plan for measuring benefits the project will
deliver. This should include any ongoing operational aspects of the
recommended option beyond initial implementation.
The business case document provides the basis to measure success and
progress throughout the project life cycle by comparing the results with the
objectives and the identified success criteria. See Business Analysis for
Practitioners: A Practice Guide [7].
1.2.6.2 PROJECT BENEFITS MANAGEMENT PLAN
The project benefits management plan is the document that describes how and
when the benefits of the project will be delivered, and describes the mechanisms
that should be in place to measure those benefits. A project benefit is defined as
an outcome of actions, behaviors, products, services, or results that provide
value to the sponsoring organization as well as to the project's intended
beneficiaries. Development of the benefits management plan begins early in the
project life cycle with the definition of the target benefits to be realized. The
benefits management plan describes key elements of the benefits and may
include but is not limited to documenting the following:
Target benefits (e.g., the expected tangible and intangible value to be
gained by the implementation of the project; financial value is
expressed as net present value);
Strategic alignment (e.g., how well the project benefits align to the
business strategies of the organization);
Timeframe for realizing benefits (e.g., benefits by phase, short-term,
long-term, and ongoing);
Benefits owner (e.g., the accountable person to monitor, record, and
report realized benefits throughout the timeframe established in the
plan);
Metrics (e.g., the measures to be used to show benefits realized, direct
measures, and indirect measures);
Assumptions (e.g., factors expected to be in place or to be in
evidence); and
Risks (e.g., risks for realization of benefits).
Developing the benefits management plan makes use of the data and
information documented in the business case and needs assessment. For
example, the cost-benefit analyses recorded in the documents illustrate the
estimate of costs compared to the value of the benefits realized by the project.
The benefits management plan and the project management plan include a
description of how the business value resulting from the project becomes part of
the organization's ongoing operations, including the metrics to be used. The
metrics provide verification of the business value and validation of the project's
success.
Development and maintenance of the project benefits management plan is an
iterative activity. This document complements the business case, project charter,
and project management plan. The project manager works with the sponsor to
ensure that the project charter, project management plan, and the benefits
management plan remain in alignment throughout the life cycle of the project.
See Business Analysis for Practitioners: A Practice Guide [7], The Standard
for Program Management [3], and The Standard for Portfolio Management
[2].
1.2.6.3 PROJECT CHARTER AND PROJECT MANAGEMENT PLAN
The project charter is defined as a document issued by the project sponsor that
formally authorizes the existence of a project and provides the project manager
with the authority to apply organizational resources to project activities.
The project management plan is defined as the document that describes how
the project will be executed, monitored, and controlled.
See Section 4 on Project Integration Management for more information on the
project charter and the project management plan.
1.2.6.4 PROJECT SUCCESS MEASURES
One of the most common challenges in project management is determining
whether or not a project is successful.
Traditionally, the project management metrics of time, cost, scope, and quality
have been the most important factors in defining the success of a project. More
recently, practitioners and scholars have determined that project success should
also be measured with consideration toward achievement of the project
objectives.
Project stakeholders may have different ideas as to what the successful
completion of a project will look like and which factors are the most important.
It is critical to clearly document the project objectives and to select objectives
that are measurable. Three questions that the key stakeholders and the project
manager should answer are:
What does success look like for this project?
How will success be measured?
What factors may impact success?
The answer to these questions should be documented and agreed upon by the
key stakeholders and the project manager.
Project success may include additional criteria linked to the organizational
strategy and to the delivery of business results. These project objectives may
include but are not limited to:
Completing the project benefits management plan;
Meeting the agreed-upon financial measures documented in the
business case. These financial measures may include but are not
limited to:
Net present value (NPV),
Return on investment (ROI),
Internal rate of return (IRR),
Payback period (PBP), and
Benefit-cost ratio (BCR).
Meeting business case nonfinancial objectives;
Completing movement of an organization from its current state to the
desired future state;
Fulfilling contract terms and conditions;
Meeting organizational strategy, goals, and objectives;
Achieving stakeholder satisfaction;
Acceptable customer/end-user adoption;
Integration of deliverables into the organization's operating
environment;
Achieving agreed-upon quality of delivery;
Meeting governance criteria; and
Achieving other agreed-upon success measures or criteria (e.g.,
process throughput).
The project team needs to be able to assess the project situation, balance the
demands, and maintain proactive communication with stakeholders in order to
deliver a successful project.
When the business alignment for a project is constant, the chance for project
success greatly increases because the project remains aligned with the strategic
direction of the organization.
It is possible for a project to be successful from a scope/schedule/budget
viewpoint, and to be unsuccessful from a business viewpoint. This can occur
when there is a change in the business needs or the market environment before
the project is completed.
2
THE ENVIRONMENT IN WHICH PROJECTS
OPERATE
2.1 OVERVIEW
Projects exist and operate in environments that may have an influence on
them. These influences can have a favorable or unfavorable impact on the
project. Two major categories of influences are enterprise environmental factors
(EEFs) and organizational process assets (OPAs).
EEFs originate from the environment outside of the project and often outside
of the enterprise. EEFs may have an impact at the organizational, portfolio,
program, or project level. See Section 2.2 for additional information on EEFs.
OPAs are internal to the organization. These may arise from the organization
itself, a portfolio, a program, another project, or a combination of these. Figure
2-1 shows the breakdown of project influences into EEFs and OPAs. See Section
2.3 for additional information on OPAs.
In addition to EEFs and OPAs, organizational systems play a significant role
in the life cycle of the project. System factors that impact the power, influence,
interests, competencies, and political capabilities of the people to act within the
organizational system are discussed further in the section on organizational
systems (see Section 2.4).
2.2 ENTERPRISE ENVIRONMENTAL FACTORS
Enterprise environmental factors (EEFs) refer to conditions, not under the
control of the project team, that influence, constrain, or direct the project. These
conditions can be internal and/or external to the organization. EEFs are
considered as inputs to many project management processes, specifically for
most planning processes. These factors may enhance or constrain project
management options. In addition, these factors may have a positive or negative
influence on the outcome.
EEFs vary widely in type or nature. These factors need to be considered if the
project is to be effective. EEFs include but are not limited to the factors
described in Sections 2.2.1 and 2.2.2.
2.2.1 EEFS INTERNAL TO THE ORGANIZATION
The following EEFs are internal to the organization:
Organizational culture, structure, and governance. Examples include
vision, mission, values, beliefs, cultural norms, leadership style,
hierarchy and authority relationships, organizational style, ethics, and
code of conduct.
Geographic distribution of facilities and resources. Examples include
factory locations, virtual teams, shared systems, and cloud computing.
Infrastructure. Examples include existing facilities, equipment,
organizational telecommunications channels, information technology
hardware, availability, and capacity.
Information technology software. Examples include scheduling
software tools, configuration management systems, web interfaces to
other online automated systems, and work authorization systems.
Resource availability. Examples include contracting and purchasing
constraints, approved providers and subcontractors, and collaboration
agreements.
Employee capability. Examples include existing human resources
expertise, skills, competencies, and specialized knowledge.
2.2.2 EEFS EXTERNAL TO THE ORGANIZATION
The following EEFs are external to the organization.
Marketplace conditions. Examples include competitors, market share
brand recognition, and trademarks.
Social and cultural influences and issues. Examples include political
climate, codes of conduct, ethics, and perceptions.
Legal restrictions. Examples include country or local laws and
regulations related to security, data protection, business conduct,
employment, and procurement.
Commercial databases. Examples include benchmarking results,
standardized cost estimating data, industry risk study information, and
risk databases.
Academic research. Examples include industry studies, publications,
and benchmarking results.
Government or industry standards. Examples include regulatory
agency regulations and standards related to products, production,
environment, quality, and workmanship.
Financial considerations. Examples include currency exchange rates,
interest rates, inflation rates, tariffs, and geographic location.
Physical environmental elements. Examples include working
conditions, weather, and constraints.
2.3 ORGANIZATIONAL PROCESS ASSETS
Organizational process assets (OPAs) are the plans, processes, policies,
procedures, and knowledge bases specific to and used by the performing
organization. These assets influence the management of the project.
OPAs include any artifact, practice, or knowledge from any or all of the
performing organizations involved in the project that can be used to execute or
govern the project. The OPAs also include the organization's lessons learned
from previous projects and historical information. OPAs may include completed
schedules, risk data, and earned value data. OPAs are inputs to many project
management processes. Since OPAs are internal to the organization, the project
team members may be able to update and add to the organizational process
assets as necessary throughout the project. They may be grouped into two
categories:
Processes, policies, and procedures; and
Organizational knowledge bases.
Generally, the assets in the first category are not updated as part of the project
work. Processes, policies, and procedures are usually established by the project
management office (PMO) or another function outside of the project. These can
be updated only by following the appropriate organizational policies associated
with updating processes, policies, or procedures. Some organizations encourage
the team to tailor templates, life cycles, and checklists for the project. In these
instances, the project management team should tailor those assets to meet the
needs of the project.
The assets in the second category are updated throughout the project with
project information. For example, information on financial performance, lessons
learned, performance metrics and issues, and defects are continually updated
throughout the project.
2.3.1 PROCESSES, POLICIES, AND PROCEDURES
The organization's processes and procedures for conducting project work
include but are not limited to:
Initiating and Planning:
Guidelines and criteria for tailoring the organization's set of standard
processes and procedures to satisfy the specific needs of the project;
Specific organizational standards such as policies (e.g., human
resources policies, health and safety policies, security and
confidentiality policies, quality policies, procurement policies, and
environmental policies);
Product and project life cycles, and methods and procedures (e.g.,
project management methods, estimation metrics, process audits,
improvement targets, checklists, and standardized process definitions
for use in the organization);
Templates (e.g., project management plans, project documents,
project registers, report formats, contract templates, risk categories,
risk statement templates, probability and impact definitions,
probability and impact matrices, and stakeholder register templates);
and
Preapproved supplier lists and various types of contractual
agreements (e.g., fixed-price, cost-reimbursable, and time and
material contracts).
Executing, Monitoring, and Controlling:
Change control procedures, including the steps by which performing
organization standards, policies, plans, and procedures or any project
documents will be modified, and how any changes will be approved
and validated;
Traceability matrices;
Financial controls procedures (e.g., time reporting, required
expenditure and disbursement reviews, accounting codes, and
standard contract provisions);
Issue and defect management procedures (e.g., defining issue and
defect controls, identifying and resolving issues and defects, and
tracking action items);
Resource availability control and assignment management;
Organizational communication requirements (e.g., specific
communication technology available, authorized communication
media, record retention policies, videoconferencing, collaborative
tools, and security requirements);
Procedures for prioritizing, approving, and issuing work
authorizations;
Templates (e.g., risk register, issue log, and change log);
Standardized guidelines, work instructions, proposal evaluation
criteria, and performance measurement criteria; and
Product, service, or result verification and validation procedures.
Closing. Project closure guidelines or requirements (e.g., final project
audits, project evaluations, deliverable acceptance, contract closure,
resource reassignment, and knowledge transfer to production and/or
operations).
2.3.2 ORGANIZATIONAL KNOWLEDGE REPOSITORIES
The organizational knowledge repositories for storing and retrieving
information include but are not limited to:
Configuration management knowledge repositories containing the
versions of software and hardware components and baselines of all
performing organization standards, policies, procedures, and any
project documents;
Financial data repositories containing information such as labor hours,
incurred costs, budgets, and any project cost overruns;
Historical information and lessons learned knowledge repositories
(e.g., project records and documents, all project closure information
and documentation, information regarding both the results of previous
project selection decisions and previous project performance
information, and information from risk management activities);
Issue and defect management data repositories containing issue and
defect status, control information, issue and defect resolution, and
action item results;
Data repositories for metrics used to collect and make available
measurement data on processes and products; and
Project files from previous projects (e.g., scope, cost, schedule, and
performance measurement baselines, project calendars, project
schedule network diagrams, risk registers, risk reports, and stakeholder
registers).
2.4 ORGANIZATIONAL SYSTEMS
2.4.1 OVERVIEW
Projects operate within the constraints imposed by the organization through
their structure and governance framework. To operate effectively and efficiently,
the project manager needs to understand where responsibility, accountability,
and authority reside within the organization. This understanding will help the
project manager effectively use his or her power, influence, competence,
leadership, and political capabilities to successfully complete the project.
The interaction of multiple factors within an individual organization creates a
unique system that impacts the project operating in that system. The resulting
organizational system determines the power, influence, interests, competence,
and political capabilities of the people who are able to act within the system. The
system factors include but are not limited to:
Management elements,
Governance frameworks, and
Organizational structure types.
The complete information and explanation of the organizational system
factors and how the combination of these factors impacts a project are beyond
the scope of this guide. There are disciplines with associated literature,
methodologies, and practices that address these factors in more depth than is
possible within this guide. This section provides an overview of these factors
and their interrelationship.
This overview begins by discussing systems in general. A system is a
collection of various components that together can produce results not obtainable
by the individual components alone. A component is an identifiable element
within the project or organization that provides a particular function or group of
related functions. The interaction of the various system components creates the
organizational culture and capabilities. There are several principles regarding
systems:
Systems are dynamic,
Systems can be optimized,
System components can be optimized,
Systems and their components cannot be optimized at the same time,
and
Systems are nonlinear in responsiveness (a change in the input does
not produce a predictable change in the output).
Multiple changes may occur within the system and between the system and its
environment. When these changes take place, adaptive behavior occurs within
the components that in turn add to the system's dynamics. The system's
dynamics are defined by the interaction between the components based on the
relationships and dependencies that exist between the components.
Systems are typically the responsibility of an organization's management. The
organization's management examines the optimization trade-offs between the
components and the system in order to take the appropriate action to achieve the
best outcomes for the organization. The results of this examination will impact
the project under consideration. Therefore, it is important that the project
manager take these results into account when determining how to fulfill the
project's objectives. In addition, the project manager should take into account the
organization's governance framework.
2.4.2 ORGANIZATIONAL GOVERNANCE FRAMEWORKS
Recent PMI research reveals that governance refers to organizational or
structural arrangements at all levels of an organization designed to determine
and influence the behavior of the organization's members [9]. This research
suggests that the concept of governance is multidimensional and:
Includes consideration of people, roles, structures, and policies; and
Requires providing direction and oversight through data and feedback.
2.4.2.1 GOVERNANCE FRAMEWORK
Governance is the framework within which authority is exercised in
organizations. This framework includes but is not limited to:
Rules,
Policies,
Procedures,
Norms,
Relationships,
Systems, and
Processes.
This framework influences how:
Objectives of the organization are set and achieved,
Risk is monitored and assessed, and
Performance is optimized.
2.4.2.2 GOVERNANCE OF PORTFOLIOS, PROGRAMS, AND PROJECTS
The Governance of Portfolios, Programs, and Projects: A Practice Guide
[10] describes a common governance framework aligning organizational project
management (OPM) and portfolio, program, and project management. The
practice guide describes four governance domains of alignment, risk,
performance, and communications. Each domain has the following functions:
oversight, control, integration, and decision making. Each function has
governance supporting processes and activities for stand-alone projects, or
projects operating within the portfolio or program environments.
Project governance refers to the framework, functions, and processes that
guide project management activities in order to create a unique product, service,
or result to meet organizational, strategic, and operational goals. There is no one
governance framework that is effective in all organizations. A governance
framework should be tailored to the organizational culture, types of projects, and
the needs of the organization in order to be effective.
For more information regarding project governance, including its
implementation, see Governance of Portfolios, Programs, and Projects: A
Practice Guide [10].
2.4.3 MANAGEMENT ELEMENTS
Management elements are the components that comprise the key functions or
principles of general management in the organization. The general management
elements are allocated within the organization according to its governance
framework and the organizational structure type selected.
The key functions or principles of management include but are not limited to:
Division of work using specialized skills and availability to perform
work;
Authority given to perform work;
Responsibility to perform work appropriately assigned based on such
attributes as skill and experience;
Discipline of action (e.g., respect for authority, people, and rules);
Unity of command (e.g., only one person gives orders for any action or
activity to an individual);
Unity of direction (e.g., one plan and one head for a group of activities
with the same objective);
General goals of the organization take precedence over individual
goals;
Paid fairly for work performed;
Optimal use of resources;
Clear communication channels;
Right materials to the right person for the right job at the right time;
Fair and equal treatment of people in the workplace;
Clear security of work positions;
Safety of people in the workplace;
Open contribution to planning and execution by each person; and
Optimal morale.
Performance of these management elements are assigned to selected
individuals within the organization. These individuals may perform the noted
functions within various organizational structures. For example, in a hierarchical
structure, there are horizontal and vertical levels within the organization. These
hierarchical levels range from the line management level through to the
executive management level. The responsibility, accountability, and authority
assigned to the hierarchical level indicate how the individual may perform the
noted function within that organizational structure.
2.4.4 ORGANIZATIONAL STRUCTURE TYPES
Determination of the appropriate organizational structure type is a result of the
study of tradeoffs between two key variables. The variables are the
organizational structure types available for use and how to optimize them for a
given organization. There is not a one-size-fits-all structure for any given
organization. The final structure for a given organization is unique due to the
numerous variables to be considered. Sections 2.4.4.1 and 2.4.4.2 give examples
of some of the factors to be included when considering the two variables given.
Section 2.4.4.3 discusses one organizational structure that is prevalent in project
management.
2.4.4.1 ORGANIZATIONAL STRUCTURE TYPES
Organizational structures take many forms or types. Table 2-1 compares
several types of organizational structures and their influence on projects.
2.4.4.2 FACTORS IN ORGANIZATION STRUCTURE SELECTION
Each organization considers numerous factors for inclusion in its
organizational structure. Each factor may carry a different level of importance in
the final analysis. The combination of the factor, its value, and relative
importance provides the organization's decision makers with the right
information for inclusion in the analysis.
Factors to consider in selecting an organizational structure include but are not
limited to:
Degree of alignment with organizational objectives,
Specialization capabilities,
Span of control, efficiency, and effectiveness,
Clear path for escalation of decisions,
Clear line and scope of authority,
Delegation capabilities,
Accountability assignment,
Responsibility assignment,
Adaptability of design,
Simplicity of design,
Efficiency of performance,
Cost considerations,
Physical locations (e.g., colocated, regional, and virtual), and
Clear communication (e.g., policies, status of work, and organization's
vision).
2.4.4.3 PROJECT MANAGEMENT OFFICE
A project management office (PMO) is an organizational structure that
standardizes the project-related governance processes and facilitates the sharing
of resources, methodologies, tools, and techniques. The responsibilities of a
PMO can range from providing project management support functions to the
direct management of one or more projects.
There are several types of PMOs in organizations. Each type varies in the
degree of control and influence it has on projects within the organization, such
as:
Supportive. Supportive PMOs provide a consultative role to projects
by supplying templates, best practices, training, access to information,
and lessons learned from other projects. This type of PMO serves as a
project repository. The degree of control provided by the PMO is low.
Controlling. Controlling PMOs provide support and require
compliance through various means. The degree of control provided by
the PMO is moderate. Compliance may involve:
Adoption of project management frameworks or methodologies;
Use of specific templates, forms, and tools; and
Conformance to governance frameworks.
Directive. Directive PMOs take control of the projects by directly
managing the projects. Project managers are assigned by and report to
the PMO. The degree of control provided by the PMO is high.
The project management office may have organization-wide responsibility. It
may play a role in supporting strategic alignment and delivering organizational
value. The PMO integrates data and information from organizational strategic
projects and evaluates how higher-level strategic objectives are being fulfilled.
The PMO is the natural liaison between the organization's portfolios, programs,
projects, and the organizational measurement systems (e.g., balanced scorecard).
The projects supported or administered by the PMO may not be related other
than by being managed together. The specific form, function, and structure of a
PMO are dependent upon the needs of the organization that it supports.
A PMO may have the authority to act as an integral stakeholder and a key
decision maker throughout the life of each project in order to keep it aligned
with the business objectives. The PMO may:
Make recommendations,
Lead knowledge transfer,
Terminate projects, and
Take other actions, as required.
A primary function of a PMO is to support project managers in a variety of
ways, which may include but are not limited to:
Managing shared resources across all projects administered by the
PMO;
Identifying and developing project management methodology, best
practices, and standards;
Coaching, mentoring, training, and oversight;
Monitoring compliance with project management standards, policies,
procedures, and templates by means of project audits;
Developing and managing project policies, procedures, templates, and
other shared documentation (organizational process assets); and
Coordinating communication across projects.
3
THE ROLE OF THE PROJECT MANAGER
3.1 OVERVIEW
The project manager plays a critical role in the leadership of a project team in
order to achieve the project's objectives. This role is clearly visible throughout
the project. Many project managers become involved in a project from its
initiation through closing. However, in some organizations, a project manager
may be involved in evaluation and analysis activities prior to project initiation.
These activities may include consulting with executive and business unit leaders
on ideas for advancing strategic objectives, improving organizational
performance, or meeting customer needs. In some organizational settings, the
project manager may also be called upon to manage or assist in business
analysis, business case development, and aspects of portfolio management for a
project. A project manager may also be involved in follow-on activities related
to realizing business benefits from the project. The role of a project manager
may vary from organization to organization. Ultimately, the project management
role is tailored to fit the organization in the same way that the project
management processes are tailored to fit the project.
A simple analogy may help in understanding the roles of a project manager
for a large project by comparing them to the roles of a conductor for a large
orchestra:
Membership and roles. A large project and an orchestra each comprise
many members, each playing a different role. A large orchestra may
have more than 100 musicians who are led by a conductor. These
musicians may play 25 different kinds of instruments placed into
major sections, such as strings, woodwinds, brass, and percussion.
Similarly, a large project may have more than 100 project members led
by a project manager. Team members may fulfill many different roles,
such as design, manufacturing, and facilities management. Like the
major sections of the orchestra, they represent multiple business units
or groups within an organization. The musicians and the project
members make up each leader's team.
Responsibility for team. The project manager and conductor are both
responsible for what their teams produce—the project outcome or the
orchestra concert, respectively. The two leaders need to take a holistic
view of their team's products in order to plan, coordinate, and
complete them. The two leaders begin by reviewing the vision,
mission, and objectives of their respective organizations to ensure
alignment with their products. The two leaders establish their
interpretation of the vision, mission, and objectives involved in
successfully completing their products. The leaders use their
interpretation to communicate and motivate their teams toward the
successful completion of their objectives.
Knowledge and skills:
The conductor is not expected to be able to play every instrument in
the orchestra, but should possess musical knowledge, understanding,
and experience. The conductor provides the orchestra with
leadership, planning, and coordination through communications. The
conductor provides written communication in the form of musical
scores and practice schedules. The conductor also communicates in
real time with the team by using a baton and other body movements.
The project manager is not expected to perform every role on the
project, but should possess project management knowledge, technical
knowledge, understanding, and experience. The project manager
provides the project team with leadership, planning, and coordination
through communications. The project manager provides written
communications (e.g., documented plans and schedules) and
communicates in real time with the team using meetings and verbal
or nonverbal cues.
The remainder of this section covers the key aspects of the role of the project
manager. While there are thousands of books and articles available on the
subject, this section is not intended to cover the entire spectrum of information
available. Rather, it is designed to present an overview that will provide the
practitioner with a basic understanding of the subject in preparation for a more
concentrated study on the various aspects discussed.
3.2 DEFINITION OF A PROJECT MANAGER
The role of a project manager is distinct from that of a functional manager or
operations manager. Typically, the functional manager focuses on providing
management oversight for a functional or business unit. Operations managers are
responsible for ensuring that business operations are efficient. The project
manager is the person assigned by the performing organization to lead the team
that is responsible for achieving the project objectives.
3.3 THE PROJECT MANAGER'S SPHERE OF INFLUENCE
3.3.1 OVERVIEW
Project managers fulfill numerous roles within their sphere of influence.
These roles reflect the project manager's capabilities and are representative of
the value and contributions of the project management profession. This section
highlights the roles of the project manager in the various spheres of influence
shown in Figure 3-1.
3.3.2 THE PROJECT
The project manager leads the project team to meet the project's objectives
and stakeholders’ expectations. The project manager works to balance the
competing constraints on the project with the resources available.
The project manager also performs communication roles between the project
sponsor, team members, and other stakeholders. This includes providing
direction and presenting the vision of success for the project. The project
manager uses soft skills (e.g., interpersonal skills and the ability to manage
people) to balance the conflicting and competing goals of the project
stakeholders in order to achieve consensus. In this context, consensus means that
the relevant stakeholders support the project decisions and actions even when
there is not 100% agreement.
Research shows that successful project managers consistently and effectively
use certain essential skills. Research reveals that the top 2% of project managers
as designated by their bosses and team members distinguish themselves by
demonstrating superior relationship and communication skills while displaying a
positive attitude [12].
The ability to communicate with stakeholders, including the team and
sponsors applies across multiple aspects of the project including, but not limited
to, the following:
Developing finely tuned skills using multiple methods (e.g., verbal,
written, and nonverbal);
Creating, maintaining, and adhering to communications plans and
schedules;
Communicating predictably and consistently;
Seeking to understand the project stakeholders’ communication needs
(communication may be the only deliverable that some stakeholders
received until the project's end product or service is completed);
Making communications concise, clear, complete, simple, relevant,
and tailored;
Including important positive and negative news;
Incorporating feedback channels; and
Relationship skills involving the development of extensive networks of
people throughout the project manager's spheres of influence. These
networks include formal networks such as organizational reporting
structures. However, the informal networks that project managers
develop, maintain, and nurture are more important. Informal networks
include the use of established relationships with individuals such as
subject matter experts and influential leaders. Use of these formal and
informal networks allows the project manager to engage multiple
people in solving problems and navigating the bureaucracies
encountered in a project.
3.3.3 THE ORGANIZATION
The project manager proactively interacts with other project managers. Other
independent projects or projects that are part of the same program may impact a
project due to but not limited to the following:
Demands on the same resources,
Priorities of funding,
Receipt or distribution of deliverables, and
Alignment of project goals and objectives with those of the
organization.
Interacting with other project managers helps to create a positive influence for
fulfilling the various needs of the project. These needs may be in the form of
human, technical, or financial resources and deliverables required by the team
for project completion. The project manager seeks ways to develop relationships
that assist the team in achieving the goals and objectives of the project.
In addition, the project manager maintains a strong advocacy role within the
organization. The project manager proactively interacts with managers within
the organization during the course of the project. The project manager also
works with the project sponsor to address internal political and strategic issues
that may impact the team or the viability or quality of the project.
The project manager may work toward increasing the project management
competency and capability within the organization as a whole and is involved in
both tacit and explicit knowledge transfer or integration initiatives (see Section
4.4 on Manage Project Knowledge). The project manager also works to:
Demonstrate the value of project management,
Increase acceptance of project management in the organization, and
Advance the efficacy of the PMO when one exists in the organization.
Depending on the organizational structure, a project manager may report to a
functional manager. In other cases, a project manager may be one of several
project managers who report to a PMO or a portfolio or program manager who is
ultimately responsible for one or more organization-wide projects. The project
manager works closely with all relevant managers to achieve the project
objectives and to ensure the project management plan aligns with the portfolio or
program plan. The project manager also works closely and in collaboration with
other roles, such as organizational managers, subject matter experts, and those
involved with business analysis. In some situations, the project manager may be
an external consultant placed in a temporary management role.
3.3.4 THE INDUSTRY
The project manager stays informed about current industry trends. The project
manager takes this information and sees how it may impact or apply to the
current projects. These trends include but are not limited to:
Product and technology development;
New and changing market niches;
Standards (e.g., project management, quality management, information
security management);
Technical support tools;
Economic forces that impact the immediate project;
Influences affecting the project management discipline; and
Process improvement and sustainability strategies.
3.3.5 PROFESSIONAL DISCIPLINE
Continuing knowledge transfer and integration is very important for the
project manager. This professional development is ongoing in the project
management profession and in other areas where the project manager maintains
subject matter expertise. This knowledge transfer and integration includes but is
not limited to:
Contribution of knowledge and expertise to others within the
profession at the local, national, and global levels (e.g., communities
of practice, international organizations); and
Participation in training, continuing education, and development:
In the project management profession (e.g., universities, PMI);
In a related profession (e.g., systems engineering, configuration
management); and
In other professions (e.g., information technology, aerospace).
3.3.6 ACROSS DISCIPLINES
A professional project manager may choose to orient and educate other
professionals regarding the value of a project management approach to the
organization. The project manager may serve as an informal ambassador by
educating the organization as to the advantages of project management with
regard to timeliness, quality, innovation, and resource management.
3.4 PROJECT MANAGER COMPETENCES
3.4.1 OVERVIEW
Recent PMI studies applied the Project Manager Competency Development
(PMCD) Framework to the skills needed by project managers through the use of
The PMI Talent Triangle® shown in Figure 3-2. The talent triangle focuses on
three key skill sets:
Technical project management. The knowledge, skills, and behaviors
related to specific domains of project, program, and portfolio
management. The technical aspects of performing one's role.
Leadership. The knowledge, skills, and behaviors needed to guide,
motivate, and direct a team, to help an organization achieve its
business goals.
Strategic and business management. The knowledge of and expertise
in the industry and organization that enhanced performance and better
delivers business outcomes.
While technical project management skills are core to program and project
management, PMI research indicates that they are not enough in today's
increasingly complicated and competitive global marketplace. Organizations are
seeking added skills in leadership and business intelligence. Members of various
organizations state their belief that these competencies can support longer-range
strategic objectives that contribute to the bottom line. To be the most effective,
project managers need to have a balance of these three skill sets.
3.4.2 TECHNICAL PROJECT MANAGEMENT SKILLS
Technical project management skills are defined as the skills to effectively
apply project management knowledge to deliver the desired outcomes for
programs or projects. There are numerous technical project management skills.
The Knowledge Areas in this guide describe many of these necessary project
management skills. Project managers frequently rely on expert judgment to
perform well. Being aware of personal expertise and where to find others with
the needed expertise are important for success as a project manager.
According to research. the top project managers consistently demonstrated
several key skills including, but not limited to, the ability to:
Focus on the critical technical project management elements for each
project they manage. This focus is as simple as having the right
artifacts readily available. At the top of the list were the following:
Critical success factors for the project,
Schedule,
Selected financial reports, and
Issue log.
Tailor both traditional and agile tools, techniques, and methods for
each project.
Make time to plan thoroughly and prioritize diligently.
Manage project elements, including, but not limited to, schedule, cost,
resources, and risks.
3.4.3 STRATEGIC AND BUSINESS MANAGEMENT SKILLS
Strategic and business management skills involve the ability to see the high-
level overview of the organization and effectively negotiate and implement
decisions and actions that support strategic alignment and innovation. This
ability may include a working knowledge of other functions such as finance,
marketing, and operations. Strategic and business management skills may also
include developing and applying pertinent product and industry expertise. This
business knowledge is also known as domain knowledge. Project managers
should be knowledgeable enough about the business to be able to:
Explain to others the essential business aspects of a project;
Work with the project sponsor, team, and subject matter experts to
develop an appropriate project delivery strategy; and
Implement that strategy in a way that maximizes the business value of
the project.
In order to make the best decisions regarding the successful delivery of their
projects, project managers should seek out and consider the expertise of the
operational managers who run the business in their organization. These
managers should know the work performed in their organization and how project
plans will affect that work. The more the project manager is able to know about
the project's subject matter, the better. At a minimum, the project manager
should be knowledgeable enough to explain to others the following aspects of
the organization:
Strategy;
Mission;
Goals and objectives;
Products and services;
Operations (e.g., location, type, technology);
The market and the market condition, such as customers, state of the
market (i.e., growing or shrinking), and time-to-market factors, etc.;
and
Competition (e.g., what, who, position in the market place).
The project manager should apply the following knowledge and information
about the organization to the project to ensure alignment:
Strategy,
Mission,
Goals and objectives,
Priority,
Tactics, and
Products or services (e.g., deliverables).
Strategic and business skills help the project manager to determine which
business factors should be considered for their project. The project manager
determines how these business and strategic factors could affect the project
while understanding the interrelationship between the project and the
organization. These factors include but are not limited to:
Risks and issues,
Financial implications,
Cost versus benefits analysis (e.g., net present value, return on
investment), including the various options considered,
Business value,
Benefits realization expectations and strategies, and
Scope, budget, schedule, and quality.
Through the application of this business knowledge, a project manager has the
ability to make the appropriate decisions and recommendations for a project. As
conditions change, the project manager should be continuously working with the
project sponsor to keep the business and the project strategies aligned.
3.4.4 LEADERSHIP SKILLS
Leadership skills involve the ability to guide, motivate, and direct a team.
These skills may include demonstrating essential capabilities such as
negotiation, resilience, communication, problem solving, critical thinking, and
interpersonal skills. Projects are becoming increasingly more complicated with
more and more businesses executing their strategy through projects. Project
management is more than just working with numbers, templates, charts, graphs,
and computing systems. A common denominator in all projects is people. People
can be counted, but they are not numbers.
3.4.4.1 DEALING WITH PEOPLE
A large part of the project manager's role involves dealing with people. The
project manager should study people's behaviors and motivations. The project
manager should strive to be a good leader, because leadership is crucial to the
success of projects in organizations. A project manager applies leadership skills
and qualities when working with all project stakeholders, including the project
team, the steering team, and project sponsors.
3.4.4.2 QUALITIES AND SKILLS OF A LEADER
Research shows that the qualities and skills of a leader include but are not
limited to:
Being a visionary (e.g., help to describe the products, goals, and
objectives of the project; able to dream and translate those dreams for
others);
Being optimistic and positive;
Being collaborative;
Managing relationships and conflict by:
Building trust;
Satisfying concerns;
Seeking consensus;
Balancing competing and opposing goals;
Applying persuasion, negotiation, compromise, and conflict
resolution skills;
Developing and nurturing personal and professional networks;
Taking a long-term view that relationships are just as important as the
project; and
Continuously developing and applying political acumen.
Communicating by:
Spending sufficient time communicating (research shows that top
project managers spend about 90% of their time on a project in
communicating);
Managing expectations;
Accepting feedback graciously;
Giving feedback constructively; and
Asking and listening.
Being respectful (helping others retain their autonomy), courteous,
friendly, kind, honest, trustworthy, loyal, and ethical;
Exhibiting integrity and being culturally sensitive, courageous, a
problem solver, and decisive;
Giving credit to others where due;
Being a life-long learner who is results- and action-oriented;
Focusing on the important things, including:
Continuously prioritizing work by reviewing and adjusting as
necessary;
Finding and using a prioritization method that works for them and the
project;
Differentiating high-level strategic priorities, especially those related
to critical success factors for the project;
Maintaining vigilance on primary project constraints;
Remaining flexible on tactical priorities; and
Being able to sift through massive amounts of information to obtain
the most important information.
Having a holistic and systemic view of the project, taking into account
internal and external factors equally;
Being able to apply critical thinking (e.g., application of analytical
methods to reach decisions) and identify him or herself as a change
agent.
Being able to build effective teams, be service-oriented, and have fun
and share humor effectively with team members.
3.4.4.3 POLITICS, POWER, AND GETTING THINGS DONE
Leadership and management are ultimately about being able to get things
done. The skills and qualities noted help the project manager to achieve the
project goals and objectives. At the root of many of these skills and qualities is
the ability to deal with politics. Politics involves influence, negotiation,
autonomy, and power.
Politics and its associated elements are not “good” or “bad,” “positive” or
“negative” alone. The better the project manager understands how the
organization works, the more likely he or she will be successful. The project
manager observes and collects data about the project and organizational
landscapes. The data then needs to be reviewed in the context of the project, the
people involved, the organization, and the environment as a whole. This review
yields the information and knowledge necessary for the project manager to plan
and implement the most appropriate action. The project manager's action is a
result of selecting the right kind of power to influence and negotiate with others.
Exercise of power also carries with it the responsibility of being sensitive to and
respectful of other people. The effective action of the project manager maintains
the autonomy of those involved. The project manager's action results in the right
people performing the activities necessary to fulfill the project's objectives.
Power can originate with traits exhibited by the individual or the organization.
Power is often supported by other people's perception of the leader. It is essential
for project managers to be aware of their relationships with other people.
Relationships enable project managers to get things done on the project. There
are numerous forms of power at the disposal of project managers. Power and its
use can be complex given its nature and the various factors at play in a project.
Various forms of power include but are not limited to:
Positional (sometimes called formal, authoritative, legitimate) (e.g.,
formal position granted in the organization or team);
Informational (e.g., control of gathering or distribution);
Referent (e.g., respect or admiration others hold for the individual,
credibility gained);
Situational (e.g., gained due to unique situation such as a specific
crisis);
Personal or charismatic (e.g., charm, attraction);
Relational (e.g., participates in networking, connections, and
alliances);
Expert (e.g., skill, information possessed; experience, training,
education, certification);
Reward-oriented (e.g., ability to give praise, monetary or other desired
items);
Punitive or coercive (e.g., ability to invoke discipline or negative
consequences);
Ingratiating (e.g., application of flattery or other common ground to
win favor or cooperation);
Pressure-based (e.g., limit freedom of choice or movement for the
purpose of gaining compliance to desired action);
Guilt-based (e.g., imposition of obligation or sense of duty);
Persuasive (e.g., ability to provide arguments that move people to a
desired course of action); and
Avoiding (e.g., refusing to participate).
Top project managers are proactive and intentional when it comes to power.
These project managers will work to acquire the power and authority they need
within the boundaries of organizational policies, protocols, and procedures rather
than wait for it to be granted.
3.4.5 COMPARISON OF LEADERSHIP AND MANAGEMENT
The words leadership and management are often used interchangeably.
However, they are not synonymous. The word management is more closely
associated with directing another person to get from one point to another using a
known set of expected behaviors. In contrast, leadership involves working with
others through discussion or debate in order to guide them from one point to
another.
The method that a project manager chooses to employ reveals a distinct
difference in behavior, self-perception, and project role. Table 3-1 compares
management and leadership on several important levels.
Project managers need to employ both leadership and management in order to
be successful. The skill is in finding the right balance for each situation. The way
in which management and leadership are employed often shows up in the project
manager's leadership style.
Table 3-1. Team Management and Team Leadership Compared
Management Leadership
Direct using positional power Guide, influence, and collaborate using relational
power
Maintain Develop
Administrate Innovate
Focus on systems and structure Focus on relationships with people
Rely on control Inspire trust
Focus on near-term goals Focus on long-range vision
Ask how and when Ask what and why
Focus on bottom line Focus on the horizon
Accept status quo Challenge status quo
Do things right Do the right things
Focus on operational issues and problem solving Focus on vision, alignment, motivation, and
inspiration
3.4.5.1 LEADERSHIP STYLES
Project managers may lead their teams in many ways. The style a project
manager selects may be a personal preference, or the result of the combination of
multiple factors associated with the project. The style a project manager uses
may change over time based on the factors in play. Major factors to consider
include but are not limited to:
Leader characteristics (e.g., attitudes, moods, needs, values, ethics);
Team member characteristics (e.g., attitudes, moods, needs, values,
ethics);
Organizational characteristics (e.g., its purpose, structure, and type of
work performed); and
Environmental characteristics (e.g., social situation, economic state,
and political elements).
Research describes numerous leadership styles that a project manager can
adopt. Some of the most common examples of these styles include but are not
limited to:
Laissez-faire (e.g., allowing the team to make their own decisions and
establish their own goals, also referred to as taking a hands-off style);
Transactional (e.g., focus on goals, feedback, and accomplishment to
determine rewards; management by exception);
Servant leader (e.g., demonstrates commitment to serve and put other
people first; focuses on other people's growth, learning, development,
autonomy, and well-being; concentrates on relationships, community
and collaboration; leadership is secondary and emerges after service);
Transformational (e.g., empowering followers through idealized
attributes and behaviors, inspirational motivation, encouragement for
innovation and creativity, and individual consideration);
Charismatic (e.g., able to inspire; is high-energy, enthusiastic, self-
confident; holds strong convictions); and
Interactional (e.g., a combination of transactional, transformational,
and charismatic).
3.4.5.2 PERSONALITY
Personality refers to the individual differences in characteristic patterns of
thinking, feeling, and behaving. Personality characteristics or traits include but
are not limited to:
Authentic (e.g., accepts others for what and who they are, show open
concern);
Courteous (e.g., ability to apply appropriate behavior and etiquette);
Creative (e.g., ability to think abstractly, to see things differently, to
innovate);
Cultural (e.g., measure of sensitivity to other cultures including values,
norms, and beliefs);
Emotional (e.g., ability to perceive emotions and the information they
present and to manage them; measure of interpersonal skills);
Intellectual (e.g., measure of human intelligence over multiple
aptitudes);
Managerial (e.g., measure of management practice and potential);
Political (e.g., measure of political intelligence and making things
happen);
Service-oriented (e.g., evidence of willingness to serve other people);
Social (e.g., ability to understand and manage people); and
Systemic (e.g., drive to understand and build systems).
An effective project manager will have some level of ability with each of
these characteristics in order to be successful. Each project, organization, and
situation requires that the project manager emphasize different aspects of
personality.
3.5 PERFORMING INTEGRATION
The role of the project manager is twofold when performing integration on the
project:
Project managers play a key role in working with the project sponsor
to understand the strategic objectives and ensure the alignment of the
project objectives and results with those of the portfolio, program, and
business areas. In this way, project managers contribute to the
integration and execution of the strategy.
Project managers are responsible for guiding the team to work together
to focus on what is really essential at the project level. This is achieved
through the integration of processes, knowledge, and people.
Integration is a critical skill for project managers. Integration is covered more
in depth in the Project Integration Management Knowledge Area of this guide.
Sections 3.5.1 through 3.5.4 focus on integration that takes place at three
different levels: the process, cognitive, and context levels. Section 3.5.4
concludes by addressing complexity and integration.
3.5.1 PERFORMING INTEGRATION AT THE PROCESS LEVEL
Project management may be seen as a set of processes and activities that are
undertaken to achieve the project objectives. Some of these processes may take
place once (e.g., the initial creation of the project charter), but many others
overlap and occur several times throughout the project. One example of this
process overlap and multiple occurrences is a change in a requirement that
impacts scope, schedule, or budget and requires a change request. Several
project management processes such as the Control Scope process and the
Perform Integrated Change Control process may involve a change request. The
Perform Integrated Change Control process occurs throughout the project for
integrating change requests.
Although there is no stated definition on how to integrate the project
processes, it is clear that a project has a small chance of meeting its objective
when the project manager fails to integrate the project processes where they
interact.
3.5.2 INTEGRATION AT THE COGNITIVE LEVEL
There are many different ways to manage a project, and the method selected
typically depends on the specific characteristics of the project including its size,
how complicated the project or organization may be, and the culture of the
performing organization. It is clear that the personal skills and abilities of the
project manager are closely related to the way in which the project is managed.
The project manager should strive to become proficient in all of the Project
Management Knowledge Areas. In concert with proficiency in these Knowledge
Areas, the project manager applies experience, insight, leadership, and technical
and business management skills to the project. Finally, it is through the project
manager's ability to integrate the processes in these Knowledge Areas that makes
it possible to achieve the desired project results.
3.5.3 INTEGRATION AT THE CONTEXT LEVEL
There have been many changes in the context in which business and projects
take place today compared to a few decades ago. New technologies have been
introduced. Social networks, multicultural aspects, virtual teams, and new values
are part of the new reality of projects. An example is knowledge and people
integration in the context of a large cross-functional project implementation
involving multiple organizations. The project manager considers the
implications of this context in communications planning and knowledge
management for guiding the project team.
Project managers need to be cognizant of the project context and these new
aspects when managing the integration. Then project managers can decide how
to best use these new elements of the environment in their projects to achieve
success.
3.5.4 INTEGRATION AND COMPLEXITY
Some projects may be referred to as complex and considered difficult to
manage. In simple terms, complex and complicated are concepts often used to
describe what is considered to be intricate or complicated.
Complexity within projects is a result of the organization's system behavior,
human behavior, and the uncertainty at work in the organization or its
environment. In Navigating Complexity: A Practice Guide [13], these three
dimensions of complexity are defined as:
System behavior. The interdependencies of components and systems.
Human behavior. The interplay between diverse individuals and
groups.
Ambiguity. Uncertainty of emerging issues and lack of understanding
or confusion.
Complexity itself is a perception of an individual based on personal
experience, observation, and skill. Rather than being complex, a project is more
accurately described as containing complexity. Portfolios, programs, and
projects may contain elements of complexity.
When approaching the integration of a project, the project manager should
consider elements that are both inside and outside of the project. The project
manager should examine the characteristics or properties of the project.
Complexity as a characteristic or property of a project is typically defined as:
Containing multiple parts,
Possessing a number of connections between the parts,
Exhibiting dynamic interactions between the parts, and
Exhibiting behavior produced as a result of those interactions that
cannot be explained as the simple sum of the parts (e.g., emergent
behavior).
Examining these various items that appear to make the project complex
should help the project manager identify key areas when planning, managing,
and controlling the project to ensure integration.
4
PROJECT INTEGRATION MANAGEMENT
Project Integration Management includes the processes and activities to
identify, define, combine, unify, and coordinate the various processes and
project management activities within the Project Management Process Groups.
In the project management context, integration includes characteristics of
unification, consolidation, communication, and interrelationship. These actions
should be applied from the start of the project through completion. Project
Integration Management includes making choices about:
Resource allocation,
Balancing competing demands,
Examining any alternative approaches,
Tailoring the processes to meet the project objectives, and
Managing the interdependencies among the Project Management
Knowledge Areas.
The Project Integration Management processes are:
4.1 Develop Project Charter—The process of developing a document that
formally authorizes the existence of a project and provides the project manager
with the authority to apply organizational resources to project activities.
4.2 Develop Project Management Plan—The process of defining, preparing,
and coordinating all plan components and consolidating them into an integrated
project management plan.
4.3 Direct and Manage Project Work—The process of leading and performing
the work defined in the project management plan and implementing approved
changes to achieve the project's objectives.
4.4 Manage Project Knowledge—The process of using existing knowledge
and creating new knowledge to achieve the project's objectives and contribute to
organizational learning.
4.5 Monitor and Control Project Work—The process of tracking, reviewing,
and reporting overall progress to meet the performance objectives defined in the
project management plan.
4.6 Perform Integrated Change Control—The process of reviewing all change
requests; approving changes and managing changes to deliverables,
organizational process assets, project documents, and the project management
plan; and communicating the decisions.
4.7 Close Project or Phase—The process of finalizing all activities for the
project, phase, or contract.
Figure 4-1 provides an overview of the Project Integration Management
processes. The Project Integration Management processes are presented as
discrete processes with defined interfaces while, in practice, they overlap and
interact in ways that cannot be completely detailed in the PMBOK® Guide.
KEY CONCEPTS FOR PROJECT INTEGRATION MANAGEMENT
Project Integration Management is specific to project managers. Whereas
other Knowledge Areas may be managed by specialists (e.g., cost analysis,
scheduling specialists, risk management experts), the accountability of Project
Integration Management cannot be delegated or transferred. The project manager
is the one who combines the results in all the other Knowledge Areas and has the
overall view of the project. The project manager is ultimately responsible for the
project as a whole.
Projects and project management are integrative by nature. For example, a
cost estimate needed for a contingency plan involves integrating the processes in
the Project Cost Management, Project Schedule Management, and Project Risk
Management Knowledge Areas. When additional risks associated with various
staffing alternatives are identified, then one or more of those processes may be
revisited.
The links among the processes in the Project Management Process Groups are
often iterative. For example, the Planning Process Group provides the Executing
Process Group with a documented project management plan early in the project
and then updates the project management plan if changes occur as the project
progresses.
Project Integration Management is about:
Ensuring that the deliverable due dates of the product, service, or
result; project life cycle; and the benefits management plan are
aligned;
Providing a project management plan to achieve the project objectives;
Ensuring the creation and the use of the appropriate knowledge to and
from the project as necessary;
Managing the performance and changes of the activities in the project
management plan;
Making integrated decisions regarding key changes impacting the
project;
Measuring and monitoring the project's progress and taking
appropriate action to meet project objectives;
Collecting data on the results achieved, analyzing the data to obtain
information, and communicating this information to relevant
stakeholders;
Completing all the work of the project and formally closing each
phase, contract, and the project as a whole; and
Managing phase transitions when necessary.
The more complex the project and the more varied the expectations of the
stakeholders, the more a sophisticated approach to integration is needed.
TRENDS AND EMERGING PRACTICES IN PROJECT INTEGRATION
MANAGEMENT
The Project Integration Management Knowledge Area requires combining the
results from all the other Knowledge Areas. Evolving trends in integration
processes include but are not limited to:
Use of automated tools. The volume of data and information that
project managers need to integrate makes it necessary to use a project
management information system (PMIS) and automated tools to
collect, analyze, and use information to meet project objectives and
realize project benefits.
Use of visual management tools. Some project teams use visual
management tools, rather than written plans and other documents, to
capture and oversee critical project elements. Making key project
elements visible to the entire team provides a real-time overview of the
project status, facilitates knowledge transfer, and empowers team
members and other stakeholders to help identify and solve issues.
Project knowledge management. The increasingly mobile and
transitory work force requires a more rigorous process of identifying
knowledge throughout the project life cycle and transferring it to the
target audience so that the knowledge is not lost.
Expanding the project manager's responsibilities. Project managers are
being called on to initiate and finalize the project, such as project
business case development and benefits management. Historically,
these activities have been the responsibility of management and the
project management office, but project managers are more frequently
collaborating with them to better meet project objectives and deliver
benefits. Project managers are also engaging in more comprehensive
identification and engagement of stakeholders. This includes managing
the interfaces with various functional and operational departments and
senior management personnel.
Hybrid methodologies. Some project management methodologies are
evolving to incorporate successfully applied new practices. Examples
include the use of agile and other iterative practices; business analysis
techniques for requirements management; tools for identifying
complex elements in projects; and organizational change management
methods to prepare for transitioning the project outputs into the
organization.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager may need to tailor the
way that Project Integration Management processes are applied. Considerations
for tailoring include but are not limited to:
Project life cycle. What is an appropriate project life cycle? What
phases should comprise the project life cycle?
Development life cycle. What development life cycle and approach are
appropriate for the product, service, or result? Is a predictive or
adaptive approach appropriate? If adaptive, should the product be
developed incrementally or iteratively? Is a hybrid approach best?
Management approaches. What management processes are most
effective based on the organizational culture and the complexity of the
project?
Knowledge management. How will knowledge be managed in the
project to foster a collaborative working environment?
Change. How will change be managed in the project?
Governance. What control boards, committees, and other stakeholders
are part of the project? What are the project status reporting
requirements?
Lessons learned. What information should be collected throughout and
at the end of the project? How will historical information and lessons
learned be made available to future projects?
Benefits. When and how should benefits be reported: at the end of the
project or at the end of each iteration or phase?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Iterative and agile approaches promote the engagement of team members as
local domain experts in integration management. The team members determine
how plans and components should integrate.
The expectations of the project manager as noted in the Key Concepts for
Integration Management do not change in an adaptive environment, but control
of the detailed product planning and delivery is delegated to the team. The
project manager's focus is on building a collaborative decision-making
environment and ensuring the team has the ability to respond to changes. This
collaborative approach can be further enhanced when team members possess a
broad skill base rather than a narrow specialization.
4.1 DEVELOP PROJECT CHARTER
Develop Project Charter is the process of developing a document that formally
authorizes the existence of a project and provides the project manager with the
authority to apply organizational resources to project activities. The key benefits
of this process are that it provides a direct link between the project and the
strategic objectives of the organization, creates a formal record of the project,
and shows the organizational commitment to the project. This process is
performed once or at predefined points in the project. The inputs, tools and
techniques, and outputs of the process are depicted in Figure 4-2. Figure 4-3
depicts the data flow diagram for the process.
The project charter establishes a partnership between the performing and
requesting organizations. In the case of external projects, a formal contract is
typically the preferred way to establish an agreement. A project charter may still
be used to establish internal agreements within an organization to ensure proper
delivery under the contract. The approved project charter formally initiates the
project. A project manager is identified and assigned as early in the project as is
feasible, preferably while the project charter is being developed and always prior
to the start of planning. The project charter can be developed by the sponsor or
the project manager in collaboration with the initiating entity. This collaboration
allows the project manager to have a better understanding of the project purpose,
objectives, and expected benefits. This understanding will better allow for
efficient resource allocation to project activities. The project charter provides the
project manager with the authority to plan, execute, and control the project.
Projects are initiated by an entity external to the project such as a sponsor,
program, or project management office (PMO), or a portfolio governing body
chairperson or authorized representative. The project initiator or sponsor should
be at a level that is appropriate to procure funding and commit resources to the
project. Projects are initiated due to internal business needs or external
influences. These needs or influences often trigger the creation of a needs
analysis, feasibility study, business case, or description of the situation that the
project will address. Chartering a project validates alignment of the project to the
strategy and ongoing work of the organization. A project charter is not
considered to be a contract because there is no consideration or money promised
or exchanged in its creation.
4.1.1 DEVELOP PROJECT CHARTER: INPUTS
4.1.1.1 BUSINESS DOCUMENTS
The business case (described in Section 1.2.6.1) and the benefits management
plan (described in Section 1.2.6.2) are sources of information about the project´s
objectives and how the project will contribute to the business goals. Although
the business documents are developed prior to the project, they are reviewed
periodically.
Business case. The approved business case, or similar, is the business
document most commonly used to create the project charter. The
business case describes the necessary information from a business
standpoint to determine whether the expected outcomes of the project
justify the required investment. It is commonly used for decision
making by managers or executives above the project level. Typically,
the business need and the cost-benefit analysis are contained in the
business case to justify and establish boundaries for the project. For
more information on the business case, see Section 1.2.6.1. The
business case is created as a result of one or more of the following:
Market demand (e.g., an automobile manufacturer authorizing a
project to build more fuel-efficient cars in response to gasoline
shortages),
Organizational need (e.g., due to high overhead costs, a company
may combine staff functions and streamline processes to reduce
costs),
Customer request (e.g., an electric utility authorizing a project to
build a new substation to serve a new industrial park),
Technological advance (e.g., an airline authorizing a new project to
develop electronic tickets instead of paper tickets based on
technological advances),
Legal requirement (e.g., a paint manufacturer authorizing a project to
establish guidelines for handling toxic materials),
Ecological impacts (e.g., a company authorizing a project to lessen
its environmental impact), or
Social need (e.g., a nongovernmental organization in a developing
country authorizing a project to provide potable water systems,
latrines, and sanitation education to communities suffering from high
rates of cholera).
The project charter incorporates the appropriate information for the project
from the business documents. The project manager does not update or modify
the business documents since they are not project documents; however, the
project manager may make recommendations.
4.1.1.2 AGREEMENTS
Described in Section 12.2.3.2. Agreements are used to define initial intentions
for a project. Agreements may take the form of contracts, memorandums of
understanding (MOUs), service level agreements (SLA), letters of agreement,
letters of intent, verbal agreements, email, or other written agreements.
Typically, a contract is used when a project is being performed for an external
customer.
4.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Develop Project
Charter process include but are not limited to:
Government or industry standards (e.g., product standards, quality
standards, safety standards, and workmanship standards),
Legal and regulatory requirements and/or constraints,
Marketplace conditions,
Organizational culture and political climate,
Organizational governance framework (a structured way to provide
control, direction, and coordination through people, policies, and
processes to meet organizational strategic and operational goals), and
Stakeholders’ expectations and risk thresholds.
4.1.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Develop Project
Charter process include but are not limited to:
Organizational standard policies, processes, and procedures;
Portfolio, program, and project governance framework (governance
functions and processes to provide guidance and decision making);
Monitoring and reporting methods;
Templates (e.g., project charter template); and
Historical information and lessons learned repository (e.g., project
records and documents, information about the results of previous
project selection decisions, and information about previous project
performance).
4.1.2 DEVELOP PROJECT CHARTER: TOOLS AND
TECHNIQUES
4.1.2.1 EXPERT JUDGMENT
Expert judgment is defined as judgment provided based upon expertise in an
application area, Knowledge Area, discipline, industry, etc., as appropriate for
the activity being performed. Such expertise may be provided by any group or
person with specialized education, knowledge, skill, experience, or training.
For this process, expertise should be considered from individuals or groups
with specialized knowledge of or training in the following topics:
Organizational strategy,
Benefits management,
Technical knowledge of the industry and focus area of the project,
Duration and budget estimation, and
Risk identification.
4.1.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Brainstorming. This technique is used to identify a list of ideas in a
short period of time. It is conducted in a group environment and is led
by a facilitator. Brainstorming comprises two parts: idea generation
and analysis. Brainstorming can be used to gather data and solutions or
ideas from stakeholders, subject matter experts, and team members
when developing the project charter.
Focus groups. Described in Section 5.2.2.2. Focus groups bring
together stakeholders and subject matter experts to learn about the
perceived project risk, success criteria, and other topics in a more
conversational way than a one-on-one interview.
Interviews. Described in Section 5.2.2.2. Interviews are used to obtain
information on high-level requirements, assumptions or constraints,
approval criteria, and other information from stakeholders by talking
directly to them.
4.1.2.3 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Conflict management. Described in Section 9.5.2.1. Conflict
management can be used to help bring stakeholders into alignment on
the objectives, success criteria, high-level requirements, project
description, summary milestones, and other elements of the charter.
Facilitation. Facilitation is the ability to effectively guide a group
event to a successful decision, solution, or conclusion. A facilitator
ensures that there is effective participation, that participants achieve a
mutual understanding, that all contributions are considered, that
conclusions or results have full buy-in according to the decision
process established for the project, and that the actions and agreements
achieved are appropriately dealt with afterward.
Meeting management. Described in Section 10.2.2.6. Meeting
management includes preparing the agenda, ensuring that a
representative for each key stakeholder group is invited, and preparing
and sending the follow-up minutes and actions.
4.1.2.4 MEETINGS
For this process, meetings are held with key stakeholders to identify the
project objectives, success criteria, key deliverables, high-level requirements,
summary milestones, and other summary information.
4.1.3 DEVELOP PROJECT CHARTER: OUTPUTS
4.1.3.1 PROJECT CHARTER
The project charter is the document issued by the project initiator or sponsor
that formally authorizes the existence of a project and provides the project
manager with the authority to apply organizational resources to project activities.
It documents the high-level information on the project and on the product,
service, or result the project is intended to satisfy, such as:
Project purpose;
Measurable project objectives and related success criteria;
High-level requirements;
High-level project description, boundaries, and key deliverables;
Overall project risk;
Summary milestone schedule;
Preapproved financial resources;
Key stakeholder list;
Project approval requirements (i.e., what constitutes project success,
who decides the project is successful, and who signs off on the
project);
Project exit criteria (i.e., what are the conditions to be met in order to
close or to cancel the project or phase);
Assigned project manager, responsibility, and authority level; and
Name and authority of the sponsor or other person(s) authorizing the
project charter.
At a high level, the project charter ensures a common understanding by the
stakeholders of the key deliverables, milestones, and the roles and
responsibilities of everyone involved in the project.
4.1.3.2 ASSUMPTION LOG
High-level strategic and operational assumptions and constraints are normally
identified in the business case before the project is initiated and will flow into
the project charter. Lower-level activity and task assumptions are generated
throughout the project such as defining technical specifications, estimates, the
schedule, risks, etc. The assumption log is used to record all assumptions and
constraints throughout the project life cycle.
4.2 DEVELOP PROJECT MANAGEMENT PLAN
Develop Project Management Plan is the process of defining, preparing, and
coordinating all plan components and consolidating them into an integrated
project management plan. The key benefit of this process is the production of a
comprehensive document that defines the basis of all project work and how the
work will be performed. This process is performed once or at predefined points
in the project. The inputs, tools and techniques, and outputs of the process are
depicted in Figure 4-4. Figure 4-5 depicts the data flow diagram for the process.
The project management plan defines how the project is executed, monitored
and controlled, and closed. The project management plan's content varies
depending on the application area and complexity of the project.
The project management plan may be either summary level or detailed. Each
component plan is described to the extent required by the specific project. The
project management plan should be robust enough to respond to an ever-
changing project environment. This agility may result in more accurate
information as the project progresses.
The project management plan should be baselined; that is, it is necessary to
define at least the project references for scope, time, and cost, so that the project
execution can be measured and compared to those references and performance
can be managed. Before the baselines are defined, the project management plan
may be updated as many times as necessary. No formal process is required at
that time. But, once it is baselined, it may only be changed through the Perform
Integrated Change Control process. Consequently, change requests will be
generated and decided upon whenever a change is requested. This results in a
project management plan that is progressively elaborated by controlled and
approved updates extending through project closure.
Projects that exist in the context of a program or portfolio should develop a
project management plan that is consistent with the program or portfolio
management plan. For example, if the program management plan indicates all
changes exceeding a specified cost need to be reviewed by the change control
board (CCB), then this process and cost threshold need to be defined in the
project management plan.
4.2.1 DEVELOP PROJECT MANAGEMENT PLAN: INPUTS
4.2.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project team uses the project charter as a
starting point for initial project planning. The type and amount of information in
the project charter varies depending on the complexity of the project and the
information known at the time of its creation. At a minimum, the project charter
should define the high-level information about the project that will be elaborated
in the various components of the project management plan.
4.2.1.2 OUTPUTS FROM OTHER PROCESSES
Outputs from many of the other processes described in Sections 5 through 13
are integrated to create the project management plan. Subsidiary plans and
baselines that are an output from other planning processes are inputs to this
process. In addition, changes to these documents may necessitate updates to the
project management plan.
4.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Develop Project
Management Plan process include but are not limited to:
Government or industry standards (e.g., product standards, quality
standards, safety standards, and workmanship standards);
Legal and regulatory requirements and/or constraints;
Project management body of knowledge for vertical market (e.g.,
construction) and/or focus area (e.g., environmental, safety, risk, or
agile software development);
Organizational structure, culture, management practices, and
sustainability;
Organizational governance framework (a structured way to provide
control, direction, and coordination through people, policies, and
processes to meet organizational strategic and operational goals); and
Infrastructure (e.g., existing facilities and capital equipment).
4.2.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Develop Project
Management Plan process include but are not limited to:
Organizational standard policies, processes, and procedures;
Project management plan template, including:
Guidelines and criteria for tailoring the organization's set of standard
processes to satisfy the specific needs of the project, and
Project closure guidelines or requirements such as the product
validation and acceptance criteria.
Change control procedures, including the steps by which official
organizational standards, policies, plans, procedures, or any project
documents will be modified and how any changes will be approved
and validated;
Monitoring and reporting methods, risk control procedures, and
communication requirements;
Project information from previous similar projects (e.g., scope, cost,
schedule and performance measurement baselines, project calendars,
project schedule network diagrams, and risk registers); and
Historical information and lessons learned repository.
4.2.2 DEVELOP PROJECT MANAGEMENT PLAN: TOOLS AND
TECHNIQUES
4.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge of or training in the following topics:
Tailoring the project management process to meet the project needs,
including the dependencies and interactions among those processes
and the essential inputs and outputs;
Developing additional components of the project management plan if
needed;
Determining the tools and techniques to be used for accomplishing
those processes;
Developing technical and management details to be included in the
project management plan;
Determining resources and skill levels needed to perform project
work;
Defining the level of configuration management to apply on the
project;
Determining which project documents will be subject to the formal
change control process; and
Prioritizing the work on the project to ensure the project resources are
allocated to the appropriate work at the appropriate time.
4.2.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Brainstorming. Described in Section 4.1.2.2. Brainstorming is
frequently used when developing the project management plan to
gather ideas and solutions about the project approach. Attendees
include the project team members although other subject matter
experts (SMEs) or stakeholders may also participate.
Checklists. Described in Section 11.2.2.2. Many organizations have
standardized checklists available based in their own experience or use
checklists from the industry. A checklist may guide the project
manager to develop the plan or may help to verify that all the required
information is included in the project management plan.
Focus groups. Described in Section 5.2.2.2. Focus groups bring
together stakeholders to discuss the project management approach and
the integration of the different components of the project management
plan.
Interviews. Described in Section 5.2.2.2. Interviews are used to obtain
specific information from stakeholders to develop the project
management plan or any component plan or project document.
4.2.2.3 INTERPERSONAL AND TEAM SKILLS
The interpersonal and team skills used when developing the project
management plan include:
Conflict management. Described in Section 9.5.2.1. Conflict
management may be necessary to bring diverse stakeholders into
alignment on all aspects of the project management plan.
Facilitation. Described in Section 4.1.2.3. Facilitation ensures that
there is effective participation, that participants achieve a mutual
understanding, that all contributions are considered, and that
conclusions or results have full buy-in according to the decision
process established for the project.
Meeting management. Described in Section 10.2.2.6. Meeting
management is necessary to ensure that the numerous meetings that
are necessary to develop, unify, and agree on the project management
plan are well run.
4.2.2.4 MEETINGS
For this process, meetings are used to discuss the project approach, determine
how work will be executed to accomplish the project objectives, and establish
the way the project will be monitored and controlled.
The project kick-off meeting is usually associated with the end of planning
and the start of executing. Its purpose is to communicate the objectives of the
project, gain the commitment of the team for the project, and explain the roles
and responsibilities of each stakeholder. The kick-off may occur at different
points in time depending on the characteristics of the project:
For small projects, there is usually only one team that performs the
planning and the execution. In this case, the kick-off occurs shortly
after initiation, in the Planning Process Group, because the team is
involved in planning.
In large projects, a project management team normally does the
majority of the planning, and the remainder of the project team is
brought on when the initial planning is complete, at the start of the
development/implementation. In this instance, the kick-off meeting
takes place with processes in the Executing Process Group.
Multiphase projects will typically include a kick-off meeting at the beginning
of each phase.
4.2.3 DEVELOP PROJECT MANAGEMENT PLAN: OUTPUTS
4.2.3.1 PROJECT MANAGEMENT PLAN
The project management plan is the document that describes how the project
will be executed, monitored and controlled, and closed. It integrates and
consolidates all of the subsidiary management plans and baselines, and other
information necessary to manage the project. The needs of the project determine
which components of the project management plan are needed.
Project management plan components include but are not limited to:
Subsidiary management plans:
Scope management plan. Described in Section 5.1.3.1. Establishes
how the scope will be defined, developed, monitored, controlled, and
validated.
Requirements management plan. Described in Section 5.1.3.2.
Establishes how the requirements will be analyzed, documented, and
managed.
Schedule management plan. Described in Section 6.1.3.1.
Establishes the criteria and the activities for developing, monitoring,
and controlling the schedule.
Cost management plan. Described in Section 7.1.3.1. Establishes
how the costs will be planned, structured, and controlled.
Quality management plan. Described in Section 8.1.3.1. Establishes
how an organization´s quality policies, methodologies, and standards
will be implemented in the project.
Resource management plan. Described in Section 9.1.3.1 Provides
guidance on how project resources should be categorized, allocated,
managed, and released.
Communications management plan. Described in Section 10.1.3.1.
Establishes how, when, and by whom information about the project
will be administered and disseminated.
Risk management plan. Described in Section 11.1.3.1. Establishes
how the risk management activities will be structured and performed.
Procurement management plan. Described in Section 12.1.3.1.
Establishes how the project team will acquire goods and services
from outside of the performing organization.
Stakeholder engagement plan. Described in Section 13.2.3.1.
Establishes how stakeholders will be engaged in project decisions
and execution, according to their needs, interests, and impact.
Baselines:
Scope baseline. Described in Section 5.4.3.1. The approved version
of a scope statement, work breakdown structure (WBS), and its
associated WBS dictionary, which is used as a basis for comparison.
Schedule baseline. Described in Section 6.5.3.1. The approved
version of the schedule model that is used as a basis for comparison
to the actual results.
Cost baseline. Described in Section 7.3.3.1. The approved version of
the time-phased project budget that is used as a basis for comparison
to the actual results.
Additional components. Most components of the project management
plan are produced as outputs from other processes, though some are
produced during this process. Those components developed as part of
this process will be dependent on the project; however, they often
include but are not limited to:
Change management plan. Describes how the change requests
throughout the project will be formally authorized and incorporated.
Configuration management plan. Describes how the information
about the items of the project (and which items) will be recorded and
updated so that the product, service, or result of the project remains
consistent and/or operative.
Performance measurement baseline. An integrated scope-schedule-
cost plan for the project work against which project execution is
compared to measure and manage performance.
Project life cycle. Describes the series of phases that a project passes
through from its initiation to its closure.
Development approach. Describes the product, service, or result
development approach, such as predictive, iterative, agile, or a hybrid
model.
Management reviews. Identifies the points in the project when the
project manager and relevant stakeholders will review the project
progress to determine if performance is as expected, or if preventive
or corrective actions are necessary.
While the project management plan is one of the primary documents used to
manage the project, other project documents are also used. These other
documents are not part of the project management plan; however, they are
necessary to manage the project effectively. Table 4-1 is a representative list of
the project management plan components and project documents.
Table 4-1. Project Management Plan and Project Documents
Project Management
Plan
Project Documents
1. Scope management plan 1. Activity attributes 19. Quality control measurements
2. Requirements management
plan
2. Activity list 20. Quality metrics
3. Schedule management plan 3. Assumption log 21. Quality report
4. Cost management plan 4. Basis of estimates 22. Requirements documentation
5. Quality management plan 5. Change log 23. Requirements traceability
matrix
6. Resource management plan 6. Cost estimates 24. Resource breakdown structure
7. Communications
management plan
7. Cost forecasts 25. Resource calendars
8. Risk management plan 8. Duration estimates 26. Resource requirements
9. Procurement management
plan
9. Issue log 27. Risk register
10. Stakeholder engagement
plan
10. Lessons learned register 28. Risk report
11. Change management plan 11. Milestone list 29. Schedule data
12. Configuration management
plan
12. Physical resource
assignments
30. Schedule forecasts
13. Scope baseline 13. Project calendars 31. Stakeholder register
14. Schedule baseline 14. Project communications 32. Team charter
15. Cost baseline 15. Project schedule 33. Test and evaluation documents
16. Performance measurement
baseline
16. Project schedule network
diagram
17. Project life cycle description 17. Project scope statement
18. Development approach 18. Project team assignments
4.3 DIRECT AND MANAGE PROJECT WORK
Direct and Manage Project Work is the process of leading and performing the
work defined in the project management plan and implementing approved
changes to achieve the project's objectives. The key benefit of this process is that
it provides overall management of the project work and deliverables, thus
improving the probability of project success. This process is performed
throughout the project. The inputs, tools and techniques, and outputs of the
process are depicted in Figure 4-6. Figure 4-7 depicts the data flow diagram for
the process.
Direct and Manage Project Work involves executing the planned project
activities to complete project deliverables and accomplish established objectives.
Available resources are allocated, their efficient use is managed, and changes in
project plans stemming from analyzing work performance data and information
are carried out. The Direct and Manage Project Work process is directly affected
by the project application area. Deliverables are produced as outputs from
processes performed to accomplish the project work as planned and scheduled in
the project management plan.
The project manager, along with the project management team, directs the
performance of the planned project activities and manages the various technical
and organizational interfaces that exist in the project. Direct and Manage Project
Work also requires review of the impact of all project changes and the
implementation of approved changes: corrective action, preventive action, and/or
defect repair.
During project execution, the work performance data is collected and
communicated to the applicable controlling processes for analysis. Work
performance data analysis provides information about the completion status of
deliverables and other relevant details about project performance. The work
performance data will also be used as an input to the Monitoring and Controlling
Process Group, and can be used as feedback into lessons learned to improve the
performance of future work packages.
4.3.1 DIRECT AND MANAGE PROJECT WORK: INPUTS
4.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Any component of the project management plan
may be an input to this process.
4.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Change log. Described in Section 4.6.3.3. The change log contains the
status of all change requests.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
are used to improve the performance of the project and to avoid
repeating mistakes. The register helps identify where to set rules or
guidelines so the team's actions are aligned.
Milestone list. Described in Section 6.2.3.3. The milestone list shows
the scheduled dates for specific milestones.
Project communications. Described in Section 10.2.3.1. Project
communications include performance reports, deliverable status, and
other information generated by the project.
Project schedule. Described in Section 6.5.3.2. The schedule includes
at least the list of work activities, their durations, resources, and
planned start and finish dates.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix links product requirements to the
deliverables that satisfy them and helps to focus on the final outcomes.
Risk register. Described in Section 11.2.3.1. The risk register provides
information on threats and opportunities that may impact project
execution.
Risk report. Described in Section 11.2.3.2. The risk report provides
information on sources of overall project risk along with summary
information on identified individual project risks.
4.3.1.3 APPROVED CHANGE REQUESTS
Described in Section 4.6.3.1. Approved change requests are an output of the
Perform Integrated Change Control process, and include those requests reviewed
and approved for implementation by the project manager or by the change
control board (CCB) when applicable. The approved change request may be a
corrective action, a preventive action, or a defect repair. Approved change
requests are scheduled and implemented by the project team and can impact any
area of the project or project management plan. The approved change requests
can also modify the formally controlled project management plan components or
project documents.
4.3.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Direct and Manage
Project Work process include but are not limited to:
Organizational structure, culture, management practices, and
sustainability;
Infrastructure (e.g., existing facilities and capital equipment); and
Stakeholder risk thresholds (e.g., allowable cost overrun percentage).
4.3.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Direct and Manage
Project Work process include but are not limited to:
Organizational standard policies, processes, and procedures;
Issue and defect management procedures defining issue and defect
controls, issue and defect identification and resolution, and action item
tracking;
Issue and defect management database(s) containing historical issue
and defect status, issue and defect resolution, and action item results;
Performance measurement database used to collect and make available
measurement data on processes and products;
Change control and risk control procedures; and
Project information from previous projects (e.g., scope, cost, schedule,
performance measurement baselines, project calendars, project
schedule network diagrams, risk registers, risk reports, and lessons
learned repository).
4.3.2 DIRECT AND MANAGE PROJECT WORK: TOOLS AND
TECHNIQUES
4.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Technical knowledge on the industry and focus area of the project,
Cost and budget management,
Legal and procurement,
Legislation and regulations, and
Organizational governance.
4.3.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
The PMIS provides access to information technology (IT) software tools, such
as scheduling software tools, work authorization systems, configuration
management systems, information collection and distribution systems, as well as
interfaces to other online automated systems such as corporate knowledge base
repositories. Automated gathering and reporting on key performance indicators
(KPI) can be part of this system.
4.3.2.3 MEETINGS
Meetings are used to discuss and address pertinent topics of the project when
directing and managing project work. Attendees may include the project
manager, the project team, and appropriate stakeholders involved or affected by
the topics addressed. Each attendee should have a defined role to ensure
appropriate participation. Types of meetings include but are not limited to: kick-
off, technical, sprint or iteration planning, Scrum daily standups, steering group,
problem solving, progress update, and retrospective meetings.
4.3.3 DIRECT AND MANAGE PROJECT WORK: OUTPUTS
4.3.3.1 DELIVERABLES
A deliverable is any unique and verifiable product, result, or capability to
perform a service that is required to be produced to complete a process, phase, or
project. Deliverables are typically the outcomes of the project and can include
components of the project management plan.
Change control should be applied once the first version of a deliverable has
been completed. The control of the multiple versions or editions of a deliverable
(e.g., documents, software, and building blocks) is supported by configuration
management tools and procedures.
4.3.3.2 WORK PERFORMANCE DATA
Work performance data are the raw observations and measurements identified
during activities being performed to carry out the project work. Data are often
viewed as the lowest level of detail from which information is derived by other
processes. Data is gathered through work execution and passed to the controlling
processes for further analysis.
Examples of work performance data include work completed, key
performance indicators (KPIs), technical performance measures, actual start and
finish dates of schedule activities, story points completed, deliverables status,
schedule progress, number of change requests, number of defects, actual costs
incurred, actual durations, etc.
4.3.3.3 ISSUE LOG
Throughout the life cycle of a project, the project manager will normally face
problems, gaps, inconsistencies, or conflicts that occur unexpectedly and that
require some action so they do not impact the project performance. The issue log
is a project document where all the issues are recorded and tracked. Data on
issues may include:
Issue type,
Who raised the issue and when,
Description,
Priority,
Who is assigned to the issue,
Target resolution date,
Status, and
Final solution.
The issue log will help the project manager effectively track and manage
issues, ensuring that they are investigated and resolved. The issue log is created
for the first time as an output of this process, although issues may happen at any
time during the project. The issue log is updated as a result of the monitoring and
control activities throughout the project's life cycle.
4.3.3.4 CHANGE REQUESTS
A change request is a formal proposal to modify any document, deliverable, or
baseline. When issues are found while project work is being performed, change
requests can be submitted, which may modify project policies or procedures,
project or product scope, project cost or budget, project schedule, or quality of
the project or product results. Other change requests cover the needed preventive
or corrective actions to forestall negative impact later in the project. Any project
stakeholder may request a change. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6). Change requests can be initiated from inside or outside the project and they
can be optional or legally/contractually mandated. Change requests may include:
Corrective action. An intentional activity that realigns the performance
of the project work with the project management plan.
Preventive action. An intentional activity that ensures the future
performance of the project work is aligned with the project
management plan.
Defect repair. An intentional activity to modify a nonconforming
product or product component.
Updates. Changes to formally controlled project documents, plans,
etc., to reflect modified or additional ideas or content.
4.3.3.5 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Any component of the project
management plan may require a change request as a result of this process.
4.3.3.6 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Activity list. Described in Section 6.2.3.1. The activity list may be
updated with additional or modified activities to be performed to
complete project work.
Assumption log. Described in Section 4.1.3.2. New assumptions and
constraints may be added, and the status of existing assumptions and
constraints may be updated or closed out.
Lessons learned register. Described in Section 4.4.3.1. Any lessons
learned that will improve performance for current or future projects is
recorded as it is learned.
Requirements documentation. Described in Section 5.2.3.1. New
requirements may be identified during this process. Progress on
meeting requirements can also be updated.
Risk register. Described in Section 11.2.3.1. New risks may be
identified and existing risks may be updated during this process. Risks
are recorded in the risk register via risk management processes.
Stakeholder register. Described in Section 13.1.3.1. Where additional
information on existing or new stakeholders is gathered as a result of
this process, it is recorded in the stakeholder register.
4.3.3.7 ORGANIZATIONAL PROCESS ASSETS UPDATES
Any organizational process asset can be updated as a result of this process.
4.4 MANAGE PROJECT KNOWLEDGE
Manage Project Knowledge is the process of using existing knowledge and
creating new knowledge to achieve the project's objectives and contribute to
organizational learning. The key benefits of this process are that prior
organizational knowledge is leveraged to produce or improve the project
outcomes, and knowledge created by the project is available to support
organizational operations and future projects or phases. This process is
performed throughout the project. The inputs, tools and techniques, and outputs
of the process are depicted in Figure 4-8. Figure 4-9 depicts the data flow
diagram for the process.
Knowledge is commonly split into “explicit” (knowledge that can be readily
codified using words, pictures, and numbers) and “tacit” (knowledge that is
personal and difficult to express, such as beliefs, insights, experience, and
“know-how”). Knowledge management is concerned with managing both tacit
and explicit knowledge for two purposes: reusing existing knowledge and
creating new knowledge. The key activities that underpin both purposes are
knowledge sharing and knowledge integration (of knowledge from different
domains, contextual knowledge, and project management knowledge).
It is a common misconception that managing knowledge involves just
documenting it so it can be shared. Another common misconception is that
managing knowledge involves just obtaining lessons learned at the end of the
project, in order to use it in the future projects. Only codified explicit knowledge
can be shared in this way. But codified explicit knowledge lacks context and is
open to different interpretations, so even though it can easily be shared, it isn't
always understood or applied in the right way. Tacit knowledge has context built
in but is very difficult to codify. It resides in the minds of individual experts or
in social groups and situations, and is normally shared through conversations and
interactions between people.
From an organizational perspective, knowledge management is about making
sure the skills, experience, and expertise of the project team and other
stakeholders are used before, during, and after the project. Because knowledge
resides in the minds of people and people cannot be forced to share what they
know (or to pay attention to others’ knowledge), the most important part of
knowledge management is creating an atmosphere of trust so that people are
motivated to share their knowledge. Even the best knowledge management tools
and techniques will not work if people are not motivated to share what they
know or to pay attention to what others know. In practice, knowledge is shared
using a mixture of knowledge management tools and techniques (interactions
between people) and information management tools and techniques (in which
people codify part of their explicit knowledge by documenting it so it can be
shared).
4.4.1 MANAGE PROJECT KNOWLEDGE: INPUTS
4.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. All components of the project management plan
are inputs.
4.4.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register provides information on effective practices in
knowledge management.
Project team assignments. Described in Section 9.3.3.1. Project team
assignments provide information on the type of competencies and
experience available in the project and the knowledge that may be
missing.
Resource breakdown structure. Described in Section 9.2.3.3. The
resource breakdown structure includes information on the composition
of the team and may help to understand what knowledge is available as
a group and what knowledge is missing.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register contains details about the identified stakeholders to help
understand the knowledge they may have.
4.4.1.3 DELIVERABLES
A deliverable is any unique and verifiable product, result, or capability to
perform a service that is required to be produced to complete a process, phase, or
project. Deliverables are typically tangible components completed to meet the
project objectives and can include components of the project management plan.
4.4.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Manage Project
Knowledge process include but are not limited to:
Organizational, stakeholder, and customer culture. The existence of
trusting working relationships and a no-blame culture is particularly
important in managing knowledge. Other factors include the value
placed on learning and social behavioral norms.
Geographic distribution of facilities and resources. The location of
team members helps determine methods for gaining and sharing
knowledge.
Organizational knowledge experts. Some organizations have a team or
individual that specializes in knowledge management.
Legal and regulatory requirements and/or constraints. These include
confidentiality of project information.
4.4.1.5 ORGANIZATIONAL PROCESS ASSETS
Knowledge about project management is often embedded in processes and
routines. The organizational process assets that can influence the Manage Project
Knowledge process include but are not limited to:
Organizational standard policies, processes, and procedures. These
may include: confidentiality and access to information; security and
data protection; record retention policies; use of copyrighted
information; destruction of classified information; format and
maximum size of files; registry data and metadata; authorized
technology and social media; etc.
Personnel administration. These include, for example, employee
development and training records, and competency frameworks that
refer to knowledge-sharing behaviors.
Organizational communication requirements. Formal, rigid
communication requirements are good for sharing information.
Informal communication is more effective for creating new knowledge
and integrating knowledge across diverse stakeholder groups.
Formal knowledge-sharing and information-sharing procedures. These
include learning reviews before, during, and after projects and project
phases; for example, identifying, capturing, and sharing lessons
learned from the current project and other projects.
4.4.2 MANAGE PROJECT KNOWLEDGE: TOOLS AND
TECHNIQUES
4.4.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Knowledge management,
Information management,
Organizational learning,
Knowledge and information management tools, and
Relevant information from other projects.
4.4.2.2 KNOWLEDGE MANAGEMENT
Knowledge management tools and techniques connect people so they can
work together to create new knowledge, share tacit knowledge, and integrate the
knowledge of diverse team members. The tools and techniques appropriate in a
project depend on the nature of the project, especially the degree of innovation
involved, the project complexity, and the level of diversity (including diversity
of disciplines) among team members.
Tools and techniques include but are not limited to:
Networking, including informal social interaction and online social
networking. Online forums where people can ask open questions
(“What does anyone know about…?”) are useful for starting
knowledge-sharing conversations with specialists;
Communities of practice (sometimes called communities of interest or
just communities) and special interest groups;
Meetings, including virtual meetings where participants can interact
using communications technology;
Work shadowing and reverse shadowing;
Discussion forums such as focus groups;
Knowledge-sharing events such as seminars and conferences;
Workshops, including problem-solving sessions and learning reviews
designed to identify lessons learned;
Storytelling;
Creativity and ideas management techniques;
Knowledge fairs and cafés; and
Training that involves interaction between learners.
All of these tools and techniques can be applied face-to-face or virtually, or
both. Face-to-face interaction is usually the most effective way to build the
trusting relationships that are needed to manage knowledge. Once relationships
are established, virtual interaction can be used to maintain the relationship.
4.4.2.3 INFORMATION MANAGEMENT
Information management tools and techniques are used to create and connect
people to information. They are effective for sharing simple, unambiguous,
codified explicit knowledge. They include but are not limited to:
Methods for codifying explicit knowledge; for example, for producing
lessons to be learned entries for the lessons learned register;
Lessons learned register;
Library services;
Information gathering, for example, web searches and reading
published articles; and
Project management information system (PMIS). Described in Section
4.3.2.2. Project management information systems often include
document management systems.
Tools and techniques that connect people to information can be enhanced by
adding an element of interaction, for example, include a “contact me” function
so users can get in touch with the originators of the lessons and ask for advice
specific to their project and context.
Interaction and support also helps people find relevant information. Asking
for help is generally quicker and easier than trying to identify search terms.
Search terms are often difficult to select because people may not know which
keywords or key phrases to use to access the information they need.
Knowledge and information management tools and techniques should be
connected to project processes and process owners. Communities of practice and
subject matter experts (SMEs), for example, may generate insights that lead to
improved control processes; having an internal sponsor can ensure
improvements are implemented. Lessons learned register entries may be
analyzed to identify common issues that can be addressed by changes to project
procedures.
4.4.2.4 INTERPERSONAL AND TEAM SKILLS
The interpersonal and team skills used include but are not limited to:
Active listening. Described in Section 10.2.2.6. Active listening helps
reduce misunderstandings and improves communication and
knowledge sharing.
Facilitation. Described in Section 4.1.2.3. Facilitation helps effectively
guide a group to a successful decision, solution, or conclusion.
Leadership. Described in Section 3.4.4. Leadership is used to
communicate the vision and inspire the project team to focus on the
appropriate knowledge and knowledge objectives.
Networking. Described in Section 10.2.2.6. Networking allows
informal connections and relations among project stakeholders to be
established and creates the conditions to share tacit and explicit
knowledge.
Political awareness. Described in Section 10.1.2.6. Political awareness
helps the project manager to plan communications based on the project
environment as well as the organization's political environment.
4.4.3 MANAGE PROJECT KNOWLEDGE: OUTPUTS
4.4.3.1 LESSONS LEARNED REGISTER
The lessons learned register can include the category and description of the
situation. The lessons learned register may also include the impact,
recommendations, and proposed actions associated with the situation. The
lessons learned register may record challenges, problems, realized risks and
opportunities, or other content as appropriate.
The lessons learned register is created as an output of this process early in the
project. Thereafter it is used as an input and updated as an output in many
processes throughout the project. The persons or teams involved in the work are
also involved in capturing the lessons learned. Knowledge can be documented
using videos, pictures, audios, or other suitable means that ensure the efficiency
of the lessons captured.
At the end of a project or phase, the information is transferred to an
organizational process asset called a lessons learned repository.
4.4.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Any component of the project
management plan may be updated as a result of this process.
4.4.3.3 ORGANIZATIONAL PROCESS ASSETS UPDATES
All projects create new knowledge. Some of this knowledge is codified,
embedded in deliverables, or embedded in improvements to processes and
procedures as a result of the Manage Project Knowledge process. Existing
knowledge can also be codified or embedded for the first time as a result of this
process; for example, if an existing idea for a new procedure is piloted in the
project and found to be successful.
Any organizational process asset can be updated as a result of this process.
4.5 MONITOR AND CONTROL PROJECT WORK
Monitor and Control Project Work is the process of tracking, reviewing, and
reporting the overall progress to meet the performance objectives defined in the
project management plan. The key benefits of this process are that it allows
stakeholders to understand the current state of the project, to recognize the
actions taken to address any performance issues, and to have visibility into the
future project status with cost and schedule forecasts. This process is performed
throughout the project. The inputs, tools and techniques, and outputs of the
process are depicted in Figure 4-10. Figure 4-11 depicts the data flow diagram
for the process.
Monitoring is an aspect of project management performed throughout the
project. Monitoring includes collecting, measuring, and assessing measurements
and trends to effect process improvements. Continuous monitoring gives the
project management team insight into the health of the project and identifies any
areas that may require special attention. Control includes determining corrective
or preventive actions or replanning and following up on action plans to
determine whether the actions taken resolved the performance issue. The
Monitor and Control Project Work process is concerned with:
Comparing actual project performance against the project management
plan;
Assessing performance periodically to determine whether any
corrective or preventive actions are indicated, and then recommending
those actions as necessary;
Checking the status of individual project risks;
Maintaining an accurate, timely information base concerning the
project's product(s) and their associated documentation through project
completion;
Providing information to support status reporting, progress
measurement, and forecasting;
Providing forecasts to update current cost and current schedule
information;
Monitoring implementation of approved changes as they occur;
Providing appropriate reporting on project progress and status to
program management when the project is part of an overall program;
and
Ensuring that the project stays aligned with the business needs.
4.5.1 MONITOR AND CONTROL PROJECT WORK: INPUTS
4.5.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Monitoring and controlling project work
involves looking at all aspects of the project. Any component of the project
management plan may be an input for this process.
4.5.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log
contains information about assumptions and constraints identified as
affecting the project.
Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. Basis of
estimates indicates how the various estimates were derived and can be
used to make a decision on how to respond to variances.
Cost forecasts. Described in Section 7.4.3.2. Based on the project's
past performance, the cost forecasts are used to determine if the project
is within defined tolerance ranges for budget and to identify any
necessary change requests.
Issue log. Described in Section 4.3.3.3. The issue log is used to
document and monitor who is responsible for resolving specific issues
by a target date.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register may have information on effective responses for
variances, and corrective and preventive actions.
Milestone list. Described in Section 6.2.3.3. The milestone list shows
the scheduled dates for specific milestones and is used to check if the
planned milestones have been met.
Quality reports. Described in Section 8.2.3.1. The quality report
includes quality management issues; recommendations for process,
project, and product improvements; corrective actions
recommendations (includes rework, defect/bugs repair, 100%
inspection, and more); and the summary of findings from the Control
Quality process.
Risk register. Described in Section 11.2.3.1. The risk register provides
information on threats and opportunities that have occurred during
project execution.
Risk report. Described in Section 11.2.3.2. The risk report provides
information on the overall project risks as well as information on
specified individual risks.
Schedule forecasts. Described in Section 6.6.3.2. Based on the
project's past performance, the schedule forecasts are used to
determine if the project is within defined tolerance ranges for schedule
and to identify any necessary change requests.
4.5.1.3 WORK PERFORMANCE INFORMATION
Work performance data is gathered through work execution and passed to the
controlling processes. To become work performance information, the work
performance data are compared with the project management plan components,
project documents, and other project variables. This comparison indicates how
the project is performing.
Specific work performance metrics for scope, schedule, budget, and quality
are defined at the start of the project as part of the project management plan.
Performance data are collected during the project through the controlling
processes and compared to the plan and other variables to provide a context for
work performance.
For example, work performance data on cost may include funds that have
been expended. However, to be useful, that data has to be compared to the
budget, the work that was performed, the resources used to accomplish the work,
and the funding schedule. This additional information provides the context to
determine if the project is on budget or if there is a variance. It also indicates the
degree of variance from the plan, and by comparing it to the variance thresholds
in the project management plan it can indicate if preventive or corrective action
is required. Interpreting work performance data and the additional information as
a whole provides a context that provides a sound foundation for project
decisions.
4.5.1.4 AGREEMENTS
Described in Section 12.2.3.2. A procurement agreement includes terms and
conditions, and may incorporate other items that the buyer specifies regarding
what the seller is to perform or provide. If the project is outsourcing part of the
work, the project manager needs to oversee the contractor's work to make certain
that all the agreements meet the specific needs of the project while adhering to
organizational procurement policies.
4.5.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Monitor and
Control Project Work process include but are not limited to:
Project management information systems such as scheduling, cost,
resourcing tools, performance indicators, databases, project records,
and financials;
Infrastructure (e.g., existing facilities and equipment, organization´s
telecommunications channels);
Stakeholders’ expectations and risk thresholds; and
Government or industry standards (e.g., regulatory agency regulations,
product standards, quality standards, and workmanship standards).
4.5.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Monitor and Control
Project Work process include but are not limited to:
Organizational standard policies, processes, and procedures;
Financial controls procedures (e.g., required expenditure and
disbursement reviews, accounting codes, and standard contract
provisions);
Monitoring and reporting methods;
Issue management procedures defining issue controls, issue
identification, and resolution and action item tracking;
Defect management procedures defining defect controls, defect
identification, and resolution and action item tracking; and
Organizational knowledge base, in particular process measurement and
the lessons learned repository.
4.5.2 MONITOR AND CONTROL PROJECT WORK: TOOLS AND
TECHNIQUES
4.5.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Earned value analysis,
Interpretation and contextualization of data,
Techniques to estimate duration and costs,
Trend analysis,
Technical knowledge on the industry and focus area of the project,
Risk management, and
Contract management.
4.5.2.2 DATA ANALYSIS
Data analysis techniques that can be used include but are not limited to:
Alternatives analysis. Alternatives analysis is used to select the
corrective actions or a combination of corrective and preventive
actions to implement when a deviation occurs.
Cost-benefit analysis. Described in Section 8.1.2.3. Cost-benefit
analysis helps to determine the best corrective action in terms of cost
in case of project deviations.
Earned value analysis. Described in Section 7.4.2.2. Earned value
provides an integrated perspective on scope, schedule, and cost
performance.
Root cause analysis. Described in Section 8.2.2.2. Root cause analysis
focuses on identifying the main reasons of a problem. It can be used to
identify the reasons for a deviation and the areas the project manager
should focus on in order to achieve the objectives of the project.
Trend analysis. Trend analysis is used to forecast future performance
based on past results. It looks ahead in the project for expected
slippages and warns the project manager ahead of time that there may
be problems later in the schedule if established trends persist. This
information is made available early enough in the project timeline to
give the project team time to analyze and correct any anomalies. The
results of trend analysis can be used to recommend preventive actions
if necessary.
Variance analysis. Variance analysis reviews the differences (or
variance) between planned and actual performance. This can include
duration estimates, cost estimates, resources utilization, resources
rates, technical performance, and other metrics. Variance analysis may
be conducted in each Knowledge Area based on its particular
variables. In Monitor and Control Project Work, the variance analysis
reviews the variances from an integrated perspective considering cost,
time, technical, and resource variances in relation to each other to get
an overall view of variance on the project. This allows for the
appropriate preventive or corrective actions to be initiated.
4.5.2.3 DECISION MAKING
A decision-making technique that can be used includes but is not limited to
voting. Described in Section 5.2.2.4. Voting can include making decisions based
on unanimity, majority, or plurality.
4.5.2.4 MEETINGS
Meetings may be face-to-face, virtual, formal, or informal. They may include
project team members and other project stakeholders when appropriate. Types of
meetings include but are not limited to user groups and review meetings.
4.5.3 MONITOR AND CONTROL PROJECT WORK: OUTPUTS
4.5.3.1 WORK PERFORMANCE REPORTS
Work performance information is combined, recorded, and distributed in a
physical or electronic form in order to create awareness and generate decisions
or actions. Work performance reports are the physical or electronic
representation of work performance information intended to generate decisions,
actions, or awareness. They are circulated to the project stakeholders through the
communication processes as defined in the project communications management
plan.
Examples of work performance reports include status reports and progress
reports. Work performance reports can contain earned value graphs and
information, trend lines and forecasts, reserve burndown charts, defect
histograms, contract performance information, and risk summaries. They can be
presented as dashboards, heat reports, stop light charts, or other representations
useful for creating awareness and generating decisions and actions.
4.5.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. As a result of comparing planned results to
actual results, change requests may be issued to expand, adjust, or reduce project
scope, product scope, or quality requirements and schedule or cost baselines.
Change requests may necessitate the collection and documentation of new
requirements. Changes can impact the project management plan, project
documents, or product deliverables. Change requests are processed for review
and disposition through the Perform Integrated Change Control process (Section
4.6). Changes may include but are not limited to:
Corrective action. An intentional activity that realigns the performance
of the project work with the project management plan.
Preventive action. An intentional activity that ensures the future
performance of the project work is aligned with the project
management plan.
Defect repair. An intentional activity that modifies a nonconforming
product or product component.
4.5.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Changes identified during the
Monitor and Control Project Work process may affect the overall project
management plan.
4.5.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Cost forecasts. Described in Section 7.4.3.2. Changes in cost forecasts
resulting from this process are recorded using cost management
processes.
Issue log. Described in Section 4.3.3.3. New issues raised as a result of
this process are recorded in the issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with effective responses for variances and
corrective and preventive actions.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
Schedule forecasts. Described in Section 6.6.3.2. Changes in schedule
forecasts resulting from this process are recorded using schedule
management processes.
4.6 PERFORM INTEGRATED CHANGE CONTROL
Perform Integrated Change Control is the process of reviewing all change
requests; approving changes and managing changes to deliverables, project
documents, and the project management plan; and communicating the decisions.
This process reviews all requests for changes to project documents, deliverables,
or the project management plan and determines the resolution of the change
requests. The key benefit of this process is that it allows for documented changes
within the project to be considered in an integrated manner while addressing
overall project risk, which often arises from changes made without consideration
of the overall project objectives or plans. This process is performed throughout
the project. The inputs, tools and techniques, and outputs of the process are
depicted in Figure 4-12. Figure 4-13 depicts the data flow diagram for the
process.
The Perform Integrated Change Control process is conducted from project
start through completion and is the ultimate responsibility of the project
manager. Change requests can impact the project scope and the product scope, as
well as any project management plan component or any project document.
Changes may be requested by any stakeholder involved with the project and may
occur at any time throughout the project life cycle. The applied level of change
control is dependent upon the application area, complexity of the specific
project, contract requirements, and the context and environment in which the
project is performed.
Before the baselines are established, changes are not required to be formally
controlled by the Perform Integrated Change Control process. Once the project is
baselined, change requests go through this process. As a general rule, each
project's configuration management plan should define which project artifacts
need to be placed under configuration control. Any change in a configuration
element should be formally controlled and will require a change request.
Although changes may be initiated verbally, they should be recorded in
written form and entered into the change management and/or configuration
management system. Change requests may require information on estimated
schedule impacts and estimated cost impacts prior to approval. Whenever a
change request may impact any of the project baselines, a formal integrated
change control process is always required. Every documented change request
needs to be either approved, deferred, or rejected by a responsible individual,
usually the project sponsor or project manager. The responsible individual will
be identified in the project management plan or by organizational procedures.
When required, the Perform Integrated Change Control process includes a
change control board (CCB), which is a formally chartered group responsible for
reviewing, evaluating, approving, deferring, or rejecting changes to the project
and for recording and communicating such decisions.
Approved change requests can require new or revised cost estimates, activity
sequences, schedule dates, resource requirements, and/or analysis of risk
response alternatives. These changes can require adjustments to the project
management plan and other project documents. Customer or sponsor approval
may be required for certain change requests after CCB approval, unless they are
part of the CCB.
4.6.1 PERFORM INTEGRATED CHANGE CONTROL: INPUTS
4.6.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Change management plan. Described in Section 4.2.3.1. The change
management plan provides the direction for managing the change
control process and documents the roles and responsibilities of the
change control board (CCB).
Configuration management plan. Described in Section 4.2.3.1. The
configuration management plan describes the configurable items of the
project and identifies the items that will be recorded and updated so
that the product of the project remains consistent and operable.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
provides the project and product definition.
Schedule baseline. Described in Section 6.5.3.1. The schedule baseline
is used to assess the impact of the changes in the project schedule.
Cost baseline. Described in Section 7.3.3.1. The cost baseline is used
to assess the impact of the changes to the project cost.
4.6.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Basis of estimates. Described in Section 6.4.3.2. Basis of estimates
indicate how the duration, cost, and resources estimates were derived
and can be used to calculate the impact of the change in time, budget,
and resources.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix helps assess the impact of the change
on the project scope.
Risk report. Described in Section 11.2.3.2. The risk report presents
information on sources of overall and individual project risks involved
by the change requested.
4.6.1.3 WORK PERFORMANCE REPORTS
Described in Section 4.5.3.1. Work performance reports of particular interest
to the Perform Integrated Change Control process include resource availability,
schedule and cost data, earned value reports, and burnup or burndown charts.
4.6.1.4 CHANGE REQUESTS
Many processes produce change requests as an output. Change requests
(described in Section 4.3.3.4) may include corrective action, preventive action,
defect repairs, as well as updates to formally controlled documents or
deliverables to reflect modified or additional ideas or content. Changes may or
may not impact the project baselines—sometimes only the performance against
the baseline is affected. Decisions on those changes are usually made by the
project manager.
Change requests that have an impact on the project baselines should normally
include information about the cost of implementing the change, modifications in
the scheduled dates, resource requirements, and risks. These changes should be
approved by the CCB (if it exists) and by the customer or sponsor, unless they
are part of the CCB. Only approved changes should be incorporated into a
revised baseline.
4.6.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Perform Integrated
Change Control process include but are not limited to:
Legal restrictions, such as country or local regulations;
Government or industry standards (e.g., product standards, quality
standards, safety standards, and workmanship standards);
Legal and regulatory requirements and/or constraints;
Organizational governance framework (a structured way to provide
control, direction, and coordination through people, policies, and
processes to meet organizational strategic and operational goals); and
Contracting and purchasing constraints.
4.6.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Perform Integrated
Change Control process include but are not limited to:
Change control procedures, including the steps by which
organizational standards, policies, plans, procedures, or any project
documents will be modified, and how any changes will be approved
and validated;
Procedures for approving and issuing change authorizations; and
Configuration management knowledge base containing the versions
and baselines of all official organizational standards, policies,
procedures, and any project documents.
4.6.2 PERFORM INTEGRATED CHANGE CONTROL: TOOLS
AND TECHNIQUES
4.6.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge of or training in the following topics:
Technical knowledge of the industry and focus area of the project,
Legislation and regulations,
Legal and procurement,
Configuration management, and
Risk management.
4.6.2.2 CHANGE CONTROL TOOLS
In order to facilitate configuration and change management, manual or
automated tools may be used. Configuration control is focused on the
specification of both the deliverables and the processes, while change control is
focused on identifying, documenting, and approving or rejecting changes to the
project documents, deliverables, or baselines.
Tool selection should be based on the needs of the project stakeholders
including organizational and environmental considerations and/or constraints.
Tools should support the following configuration management activities:
Identify configuration item. Identification and selection of a
configuration item to provide the basis for which the product
configuration is defined and verified, products and documents are
labeled, changes are managed, and accountability is maintained.
Record and report configuration item status. Information recording and
reporting about each configuration item.
Perform configuration item verification and audit. Configuration
verification and configuration audits ensure that the composition of a
project's configuration items is correct and that corresponding changes
are registered, assessed, approved, tracked, and correctly implemented.
This ensures that the functional requirements defined in the
configuration documentation are met.
Tools should support the following change management activities as well:
Identify changes. Identifying and selecting a change item for processes
or project documents.
Document changes. Documenting the change into a proper change
request.
Decide on changes. Reviewing the changes; approving, rejecting,
deferring, or making any other decision about changes to the project
documents, deliverables, or baselines.
Track changes. Verifying that the changes are registered, assessed,
approved, and tracked and communicating final results to stakeholders.
Tools are also used to manage the change requests and the resulting decisions.
Additional considerations should be made for communications to assist the
change control board (CCB) members in their duties, as well as to distribute the
decisions to the appropriate stakeholders.
4.6.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Alternatives analysis. Described in Section 9.2.2.5. This technique is
used to assess the requested changes and decide which are accepted,
rejected, or need to be modified to be finally accepted.
Cost-benefit analysis. Described in Section 8.1.2.3. This analysis helps
to determine if the requested change is worth its associated cost.
4.6.2.4 DECISION MAKING
Decision-making techniques that can be used for this process include but are
not limited to:
Voting. Described in Section 5.2.2.4. Voting can take the form of
unanimity, majority, or plurality to decide on whether to accept, defer,
or reject change requests.
Autocratic decision making. In this decision-making technique, one
individual takes the responsibility for making the decision for the
entire group.
Multicriteria decision analysis. Described in Section 8.1.2.4. This
technique uses a decision matrix to provide a systematic analytical
approach to evaluate the requested changes according to a set of
predefined criteria.
4.6.2.5 MEETINGS
Change control meetings are held with a change control board (CCB) that is
responsible for meeting and reviewing the change requests and approving,
rejecting, or deferring change requests. Most changes will have some sort of
impact on time, cost, resources, or risks. Assessing the impact of the changes is
an essential part of the meeting. Alternatives to the requested changes may also
be discussed and proposed. Finally, the decision is communicated to the request
owner or group.
The CCB may also review configuration management activities. The roles and
responsibilities of these boards are clearly defined and agreed upon by the
appropriate stakeholders and are documented in the change management plan.
CCB decisions are documented and communicated to the stakeholders for
information and follow-up actions.
4.6.3 PERFORM INTEGRATED CHANGE CONTROL: OUTPUTS
4.6.3.1 APPROVED CHANGE REQUESTS
Change requests (described in Section 4.3.3.4) are processed according to the
change management plan by the project manager, CCB, or an assigned team
member. As a result, changes may be approved, deferred, or rejected. Approved
change requests will be implemented through the Direct and Manage Project
Work process. Deferred or rejected change requests are communicated to the
person or group requesting the change.
The disposition of all change requests are recorded in the change log as a
project document update.
4.6.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any formally controlled component of the project management plan may be
changed as a result of this process. Changes to baselines are only made from the
last baseline forward. Past performance is not changed. This protects the
integrity of the baselines and the historical data of past performance.
4.6.3.3 PROJECT DOCUMENTS UPDATES
Any formally controlled project document may be changed as a result of this
process. A project document that is normally updated as a result of this process
is the change log. The change log is used to document changes that occur during
a project.
4.7 CLOSE PROJECT OR PHASE
Close Project or Phase is the process of finalizing all activities for the project,
phase, or contract. The key benefits of this process are the project or phase
information is archived, the planned work is completed, and organizational team
resources are released to pursue new endeavors. This process is performed once
or at predefined points in the project. The inputs, tools and techniques, and
outputs of the process are depicted in Figure 4-14. Figure 4-15 depicts the data
flow diagram for the process.
When closing the project, the project manager reviews the project
management plan to ensure that all project work is completed and that the
project has met its objectives. The activities necessary for the administrative
closure of the project or phase include but are not limited to:
Actions and activities necessary to satisfy completion or exit criteria
for the phase or project such as:
Making certain that all documents and deliverables are up-to-date and
that all issues are resolved;
Confirming the delivery and formal acceptance of deliverables by the
customer;
Ensuring that all costs are charged to the project;
Closing project accounts;
Reassigning personnel;
Dealing with excess project material;
Reallocating project facilities, equipment, and other resources; and
Elaborating the final project reports as required by organizational
policies.
Activities related to the completion of the contractual agreements
applicable to the project or project phase such as:
Confirming the formal acceptance of the seller's work,
Finalizing open claims,
Updating records to reflect final results, and
Archiving such information for future use.
Activities needed to:
Collect project or phase records,
Audit project success or failure,
Manage knowledge sharing and transfer,
Identify lessons learned, and
Archive project information for future use by the organization.
Actions and activities necessary to transfer the project's products,
services, or results to the next phase or to production and/or
operations.
Collecting any suggestions for improving or updating the policies and
procedures of the organization, and sending them to the appropriate
organizational unit.
Measuring stakeholder satisfaction.
The Close Project or Phase process also establishes the procedures to
investigate and document the reasons for actions taken if a project is terminated
before completion. In order to successfully achieve this, the project manager
needs to engage all the proper stakeholders in the process.
4.7.1 CLOSE PROJECT OR PHASE: INPUTS
4.7.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter documents the project
success criteria, the approval requirements, and who will sign off on the project.
4.7.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. All components of the project management plan
are an input to this process.
4.7.1.3 PROJECT DOCUMENTS
Project documents that may be inputs for this process include but are not
limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log has
a record of all the assumptions and constraints that guided the
technical specifications, estimates, schedule, risks, etc.
Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. The basis
of estimates is used to evaluate how the estimation of durations, cost,
resources, and cost control compared to the actual results.
Change log. Described in Section 4.6.3.3. The change log contains the
status of all change requests throughout the project or phase.
Issue log. Described in Section 4.3.3.3. The issue log is used to check
that there is no open issue.
Lessons learned register. Described in Section 4.3.3.1. The lessons
learned in the phase or project will be finalized before being entered
into the lessons learned repository.
Milestone list. Described in Section 6.2.3.3. The milestone list shows
the final dates on which the project milestones have been
accomplished.
Project communications. Described in Section 10.2.3.1. Project
communications include any and all communications that have been
created throughout the project.
Quality control measurements. Described in Section 8.3.3.1. The
quality control measurements document the results of Control Quality
activities and demonstrate compliance with the quality requirements.
Quality reports. Described in Section 8.2.3.1. The information
presented in the quality report may include all quality assurance issues
managed or escalated by the team, recommendations for improvement,
and the summary of findings from the Control Quality process.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation is used to demonstrate compliance with
the project scope.
Risk register. Described in Section 11.2.3.1. The risk register provides
information on risks that have occurred throughout the project.
Risk report. Described in Section 11.2.3.2. The risk report provides
information on the risk status and is used to check that there are no
open risks at the end of the project.
4.7.1.4 ACCEPTED DELIVERABLES
Described in Section 5.5.3.1. Accepted deliverables may include approved
product specifications, delivery receipts, and work performance documents.
Partial or interim deliverables may also be included for phased or cancelled
projects.
4.7.1.5 BUSINESS DOCUMENTS
Described in Section 1.2.6. Business documents include but are not limited to:
Business case. The business case documents the business need and the
cost benefit analysis that justify the project.
Benefits management plan. The benefits management plan outlines the
target benefits of the project.
The business case is used to determine if the expected outcomes from the
economic feasibility study used to justify the project occurred. The benefits
management plan is used to measure whether the benefits of the project were
achieved as planned.
4.7.1.6 AGREEMENTS
Described in Section 12.2.3.2. The requirements for formal procurement
closure are usually defined in the terms and conditions of the contract and are
included in the procurement management plan. A complex project may involve
managing multiple contracts simultaneously or in sequence.
4.7.1.7 PROCUREMENT DOCUMENTATION
Described in Section 12.3.1.4. To close the contract, all procurement
documentation is collected, indexed, and filed. Information on contract schedule,
scope, quality, and cost performance along with all contract change
documentation, payment records, and inspection results are cataloged. “As-built”
plans/drawing or “as-developed” documents, manuals, troubleshooting, and
other technical documentation should also be considered as part of the
procurement documents when closing a project. This information can be used for
lessons learned information and as a basis for evaluating contractors for future
contracts.
4.7.1.8 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Close Project or Phase
process include but are not limited to:
Project or phase closure guidelines or requirements (e.g., lessons
learned, final project audits, project evaluations, product validations,
acceptance criteria, contract closure, resource reassignment, team
performance appraisals, and knowledge transfer).
Configuration management knowledge base containing the versions
and baselines of all official organizational standards, policies,
procedures, and any project documents.
4.7.2 CLOSE PROJECT OR PHASE: TOOLS AND TECHNIQUES
4.7.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Management control,
Audit,
Legal and procurement, and
Legislation and regulations.
4.7.2.2 DATA ANALYSIS
Data analysis techniques that can be used in project closeout include but are
not limited to:
Document analysis. Described in Section 5.2.2.3. Assessing available
documentation will allow identifying lessons learned and knowledge
sharing for future projects and organizational assets improvement.
Regression analysis. This technique analyzes the interrelationships
between different project variables that contributed to the project
outcomes to improve performance on future projects.
Trend analysis. Described in Section 4.5.2.2. Trend analysis can be
used to validate the models used in the organization and to implement
adjustments for future projects.
Variance analysis. Described in Section 4.5.2.2. Variance analysis can
be used to improve the metrics of the organization by comparing what
was initially planned and the end result.
4.7.2.3 MEETINGS
Meetings are used to confirm that the deliverables have been accepted, to
validate that the exit criteria have been met, to formalize the completion of the
contracts, to evaluate the satisfaction of the stakeholders, to gather lessons
learned, to transfer knowledge and information from the project, and to celebrate
success. Attendees may include project team members and other stakeholders
involved in or affected by the project. Meetings may be face-to-face, virtual,
formal, or informal. Types of meetings include but are not limited to close-out
reporting meetings, customer wrap-up meetings, lessons learned meetings, and
celebration meetings.
4.7.3 CLOSE PROJECT OR PHASE: OUTPUTS
4.7.3.1 PROJECT DOCUMENTS UPDATES
All project documents may be updated and marked as final versions as a result
of project closure. Of particular interest is the lessons learned register, which is
finalized to include final information on phase or project closure. The final
lessons learned register may include information on benefits management,
accuracy of the business case, project and development life cycles, risk and issue
management, stakeholder engagement, and other project management processes.
4.7.3.2 FINAL PRODUCT, SERVICE, OR RESULT TRANSITION
A product, service, or result, once delivered by the project, may be handed
over to a different group or organization that will operate, maintain, and support
it throughout its life cycle.
This output refers to this transition of the final product, service, or result that
the project was authorized to produce (or in the case of phase closure, the
intermediate product, service, or result of that phase) from one team to another.
4.7.3.3 FINAL REPORT
The final report provides a summary of the project performance. It can include
information such as:
Summary level description of the project or phase.
Scope objectives, the criteria used to evaluate the scope, and evidence
that the completion criteria were met.
Quality objectives, the criteria used to evaluate the project and product
quality, the verification and actual milestone delivery dates, and
reasons for variances.
Cost objectives, including the acceptable cost range, actual costs, and
reasons for any variances.
Summary of the validation information for the final product, service,
or result.
Schedule objectives including whether results achieved the benefits
that the project was undertaken to address. If the benefits are not met
at the close of the project, indicate the degree to which they were
achieved and estimate for future benefits realization.
Summary of how the final product, service, or result achieved the
business needs identified in the business plan. If the business needs are
not met at the close of the project, indicate the degree to which they
were achieved and estimate for when the business needs will be met in
the future.
Summary of any risks or issues encountered on the project and how
they were addressed.
4.7.3.4 ORGANIZATIONAL PROCESS ASSET UPDATES
Organizational process assets that are updated include but are not limited to:
Project documents. Documentation resulting from the project's
activities; for example, project management plan; scope, cost,
schedule, and project calendars; and change management
documentation.
Operational and support documents. Documents required for an
organization to maintain, operate, and support the product or service
delivered by the project. These may be new documents or updates to
existing documents.
Project or phase closure documents. Project or phase closure
documents, consisting of formal documentation that indicates
completion of the project or phase and the transfer of the completed
project or phase deliverables to others, such as an operations group or
to the next phase. During project closure, the project manager reviews
prior phase documentation, customer acceptance documentation from
the Validate Scope process (Section 5.5), and the agreement (if
applicable) to ensure that all project requirements are completed prior
to finalizing the closure of the project. If the project was terminated
prior to completion, the formal documentation indicates why the
project was terminated and formalizes the procedures for the transfer
of the finished and unfinished deliverables of the cancelled project to
others.
Lessons learned repository. Lessons learned and knowledge gained
throughout the project are transferred to the lessons learned repository
for use by future projects.
5
PROJECT SCOPE MANAGEMENT
Project Scope Management includes the processes required to ensure that the
project includes all the work required, and only the work required, to complete
the project successfully. Managing the project scope is primarily concerned with
defining and controlling what is and is not included in the project.
The Project Scope Management processes are:
5.1 Plan Scope Management—The process of creating a scope management
plan that documents how the project and product scope will be defined,
validated, and controlled.
5.2 Collect Requirements—The process of determining, documenting, and
managing stakeholder needs and requirements to meet project objectives.
5.3 Define Scope—The process of developing a detailed description of the
project and product.
5.4 Create WBS—The process of subdividing project deliverables and project
work into smaller, more manageable components.
5.5 Validate Scope—The process of formalizing acceptance of the completed
project deliverables.
5.6 Control Scope—The process of monitoring the status of the project and
product scope and managing changes to the scope baseline.
Figure 5-1 provides an overview of the Project Scope Management processes.
The Project Scope Management processes are presented as discrete processes
with defined interfaces while, in practice, they overlap and interact in ways that
cannot be completely detailed in the PMBOK® Guide.
KEY CONCEPTS FOR PROJECT SCOPE MANAGEMENT
In the project context, the term “scope” can refer to:
Product scope. The features and functions that characterize a product,
service, or result.
Project scope. The work performed to deliver a product, service, or
result with the specified features and functions. The term “project
scope” is sometimes viewed as including product scope.
Project life cycles can range along a continuum from predictive approaches at
one end to adaptive or agile approaches at the other. In a predictive life cycle,
the project deliverables are defined at the beginning of the project and any
changes to the scope are progressively managed. In an adaptive or agile life
cycle, the deliverables are developed over multiple iterations where a detailed
scope is defined and approved for each iteration when it begins.
Projects with adaptive life cycles are intended to respond to high levels of
change and require ongoing stakeholder engagement. The overall scope of an
adaptive project will be decomposed into a set of requirements and work to be
performed, sometimes referred to as a product backlog. At the beginning of an
iteration, the team will work to determine how many of the highest-priority
items on the backlog list can be delivered within the next iteration. Three
processes (Collect Requirements, Define Scope, and Create WBS) are repeated
for each iteration. On the contrary, in a predictive project, these processes are
performed toward the beginning of the project and updated as necessary, using
the integrated change control process.
In an adaptive or agile life cycle, the sponsor and customer representatives
should be continuously engaged with the project to provide feedback on
deliverables as they are created and to ensure that the product backlog reflects
their current needs. Two processes (Validate Scope and Control Scope) are
repeated for each iteration. On the contrary, in a predictive project, Validate
Scope occurs with each deliverable or phase review and Control Scope is an
ongoing process.
In predictive projects, the scope baseline for the project is the approved
version of the project scope statement, work breakdown structure (WBS), and its
associated WBS dictionary. A baseline can be changed only through formal
change control procedures and is used as a basis for comparison while
performing Validate Scope and Control Scope processes as well as other
controlling processes. Projects with adaptive life cycles use backlogs (including
product requirements and user stories) to reflect their current needs.
Completion of the project scope is measured against the project management
plan, while completion of the product scope is measured against the product
requirements. The term “requirement” is defined as a condition or capability that
is required to be present in a product, service, or result to satisfy an agreement or
other formally imposed specification.
Validate Scope is the process of formalizing acceptance of the completed
project deliverables. The verified deliverables obtained from the Control Quality
process are an input to the Validate Scope process. One of the outputs of
Validate Scope is accepted deliverables that are formally signed off and
approved by the authorized stakeholder. Therefore, the stakeholder needs to get
involved early on during planning (sometimes initiating as well) and to provide
inputs about quality of deliverables so that Control Quality can assess the
performance and recommend necessary changes.
TRENDS AND EMERGING PRACTICES IN PROJECT SCOPE
MANAGEMENT
Requirements have always been a concern in project management and have
continued to gain more attention in the profession. As the global environment
becomes more complex, organizations are starting to recognize how to use
business analysis to their competitive advantage by defining, managing, and
controlling requirements activities. Activities of business analysis may start
before a project is initiated and a project manager is assigned. According to
Requirements Management: A Practice Guide [14], the requirements
management process starts with a needs assessment, which may begin in
portfolio planning, in program planning, or within a discrete project.
Eliciting, documenting, and managing stakeholder requirements takes place
within the Project Scope Management processes. Trends and emerging practices
for Project Scope Management include but are not limited to a focus on
collaborating with business analysis professionals to:
Determine problems and identify business needs;
Identify and recommend viable solutions for meeting those needs;
Elicit, document, and manage stakeholder requirements in order to
meet business and project objectives; and
Facilitate the successful implementation of the product, service, or end
result of the program or project [7].
The process ends with the requirements closure, which transitions the product,
service, or result to the recipient in order to measure, monitor, realize, and
sustain benefits over time.
The role with responsibility to conduct business analysis should be assigned to
resources with sufficient business analysis skills and expertise. If a business
analyst is assigned to a project, requirement-related activities are the
responsibility of that role. The project manager is responsible for ensuring that
requirements-related work is accounted for in the project management plan and
that requirements-related activities are performed on time and within budget and
deliver value.
The relationship between a project manager and a business analyst should be a
collaborative partnership. A project will have a higher likelihood of being
successful if project managers and business analysts fully understand each
other's roles and responsibilities to successfully achieve project objectives.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager will need to tailor the way
Project Scope Management processes are applied. Considerations for tailoring
include but are not limited to:
Knowledge and requirements management. Does the organization
have formal or informal knowledge and requirements management
systems? What guidelines should the project manager establish for
requirements to be reused in the future?
Validation and control. Does the organization have existing formal or
informal validation and control-related policies, procedures, and
guidelines?
Development approach. Does the organization use agile approaches in
managing projects? Is the development approach iterative or
incremental? Is a predictive approach used? Will a hybrid approach be
productive?
Stability of requirements. Are there areas of the project with unstable
requirements? Do unstable requirements necessitate the use of lean,
agile, or other adaptive techniques until they are stable and well
defined?
Governance. Does the organization have formal or informal audit and
governance policies, procedures, and guidelines?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
In projects with evolving requirements, high risk, or significant uncertainty,
the scope is often not understood at the beginning of the project or it evolves
during the project. Agile methods deliberately spend less time trying to define
and agree on scope in the early stage of the project and spend more time
establishing the process for its ongoing discovery and refinement. Many
environments with emerging requirements find that there is often a gap between
the real business requirements and the business requirements that were originally
stated. Therefore, agile methods purposefully build and review prototypes and
release versions in order to refine the requirements. As a result, scope is defined
and redefined throughout the project. In agile approaches, the requirements
constitute the backlog.
5.1 PLAN SCOPE MANAGEMENT
Plan Scope Management is the process of creating a scope management plan
that documents how the project and product scope will be defined, validated, and
controlled. The key benefit of this process is that it provides guidance and
direction on how scope will be managed throughout the project. This process is
performed once or at predefined points in the project. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 5-2. Figure 5-3
depicts the data flow diagram of the process.
The scope management plan is a component of the project or program
management plan that describes how the scope will be defined, developed,
monitored, controlled, and validated. The development of the scope management
plan and the detailing of the project scope begin with the analysis of information
contained in the project charter (Section 4.1.3.1), the latest approved subsidiary
plans of the project management plan (Section 4.2.3.1), historical information
contained in the organizational process assets (Section 2.3), and any other
relevant enterprise environmental factors (Section 2.2).
5.1.1 PLAN SCOPE MANAGEMENT: INPUTS
5.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter documents the project
purpose, high-level project description, assumptions, constraints, and high-level
requirements that the project is intended to satisfy.
5.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Quality management plan. Described in Section 8.1.3.1. The way the
project and product scope will be managed can be influenced by how
the organization's quality policy, methodologies, and standards are
implemented on the project.
Project life cycle description. The project life cycle determines the
series of phases that a project passes through from its inception to the
end of the project.
Development approach. The development approach defines whether
waterfall, iterative, adaptive, agile, or a hybrid development approach
will be used.
5.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Scope
Management process include but are not limited to:
Organization's culture,
Infrastructure,
Personnel administration, and
Marketplace conditions.
5.1.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Scope
Management process include but are not limited to:
Policies and procedures, and
Historical information and lessons learned repositories.
5.1.2 PLAN SCOPE MANAGEMENT: TOOLS AND
TECHNIQUES
5.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Previous similar projects, and
Information in the industry, discipline, and application area.
5.1.2.2 DATA ANALYSIS
A data analysis technique that can be used for this process includes but is not
limited to alternatives analysis. Various ways of collecting requirements,
elaborating the project and product scope, creating the product, validating the
scope, and controlling the scope are evaluated.
5.1.2.3 MEETINGS
Project teams may attend project meetings to develop the scope management
plan. Attendees may include the project manager, the project sponsor, selected
project team members, selected stakeholders, anyone with responsibility for any
of the scope management processes, and others as needed.
5.1.3 PLAN SCOPE MANAGEMENT: OUTPUTS
5.1.3.1 SCOPE MANAGEMENT PLAN
The scope management plan is a component of the project management plan
that describes how the scope will be defined, developed, monitored, controlled,
and validated. The components of a scope management plan include:
Process for preparing a project scope statement;
Process that enables the creation of the WBS from the detailed project
scope statement;
Process that establishes how the scope baseline will be approved and
maintained; and
Process that specifies how formal acceptance of the completed project
deliverables will be obtained.
The scope management plan can be formal or informal, broadly framed or
highly detailed, based on the needs of the project.
5.1.3.2 REQUIREMENTS MANAGEMENT PLAN
The requirements management plan is a component of the project
management plan that describes how project and product requirements will be
analyzed, documented, and managed. According to Business Analysis for
Practitioners: A Practice Guide [7], some organizations refer to it as a business
analysis plan. Components of the requirements management plan can include but
are not limited to:
How requirements activities will be planned, tracked, and reported;
Configuration management activities such as: how changes will be
initiated; how impacts will be analyzed; how they will be traced,
tracked, and reported; as well as the authorization levels required to
approve these changes;
Requirements prioritization process;
Metrics that will be used and the rationale for using them; and
Traceability structure that reflects the requirement attributes captured
on the traceability matrix.
5.2 COLLECT REQUIREMENTS
Collect Requirements is the process of determining, documenting, and
managing stakeholder needs and requirements to meet objectives. The key
benefit of this process is that it provides the basis for defining the product scope
and project scope. This process is performed once or at predefined points in the
project. The inputs, tools and techniques, and outputs of this process are depicted
in Figure 5-4. Figure 5-5 depicts the data flow diagram of the process.
The PMBOK® Guide does not specifically address product requirements
since those are industry specific. Note that Business Analysis for Practitioners:
A Practice Guide [7] provides more in-depth information about product
requirements. The project's success is directly influenced by active stakeholder
involvement in the discovery and decomposition of needs into project and
product requirements and by the care taken in determining, documenting, and
managing the requirements of the product, service, or result of the project.
Requirements include conditions or capabilities that are required to be present in
a product, service, or result to satisfy an agreement or other formally imposed
specification. Requirements include the quantified and documented needs and
expectations of the sponsor, customer, and other stakeholders. These
requirements need to be elicited, analyzed, and recorded in enough detail to be
included in the scope baseline and to be measured once project execution begins.
Requirements become the foundation of the WBS. Cost, schedule, quality
planning, and procurement are all based on these requirements.
5.2.1 COLLECT REQUIREMENTS: INPUTS
5.2.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter documents the high-level
project description and high-level requirements that will be used to develop
detailed requirements.
5.2.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan contains information on how the project scope will
be defined and developed.
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan has information on how project
requirements will be collected, analyzed, and documented.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan is used to understand stakeholder
communication requirements and the level of stakeholder engagement
in order to assess and adapt to the level of stakeholder participation in
requirements activities.
5.2.1.3 PROJECT DOCUMENTS
Examples of project documents that can be considered as inputs for this
process include but are not limited to:
Assumption Log. Described in Section 4.1.3.2. The assumption log
identified assumptions about the product, project, environment,
stakeholders, and other factors that can influence requirements.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is used to provide information on effective
requirements collection techniques, especially for projects that are
using an iterative or adaptive product development methodology.
Stakeholder Register. Described in Section 13.1.3.1. The stakeholder
register is used to identify stakeholders who can provide information
on the requirements. It also captures requirements and expectations
that stakeholders have for the project.
5.2.1.4 BUSINESS DOCUMENTS
Described in Section 1.2.6. A business document that can influence the
Collect Requirements process is the business case, which can describe required,
desired, and optional criteria for meeting the business needs.
5.2.1.5 AGREEMENTS
Described in Section 12.2.3.2. Agreements can contain project and product
requirements.
5.2.1.6 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Collect
Requirements process include but are not limited to:
Organization's culture,
Infrastructure,
Personnel administration, and
Marketplace conditions.
5.2.1.7 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Collect Requirements
process include but are not limited to:
Policies and procedures, and
Historical information and lessons learned repository with information
from previous projects.
5.2.2 COLLECT REQUIREMENTS: TOOLS AND TECHNIQUES
5.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Business analysis,
Requirements elicitation,
Requirements analysis,
Requirements documentation,
Project requirements in previous similar projects,
Diagramming techniques,
Facilitation, and
Conflict management.
5.2.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Brainstorming. Described in Section 4.1.2.2. Brainstorming is a
technique used to generate and collect multiple ideas related to project
and product requirements.
Interviews. An interview is a formal or informal approach to elicit
information from stakeholders by talking to them directly. It is
typically performed by asking prepared and spontaneous questions and
recording the responses. Interviews are often conducted on an
individual basis between an interviewer and an interviewee, but may
involve multiple interviewers and/or multiple interviewees.
Interviewing experienced project participants, sponsors, other
executives, and subject matter experts can aid in identifying and
defining the features and functions of the desired product deliverables.
Interviews are also useful for obtaining confidential information.
Focus groups. Focus groups bring together prequalified stakeholders
and subject matter experts to learn about their expectations and
attitudes about a proposed product, service, or result. A trained
moderator guides the group through an interactive discussion designed
to be more conversational than a one-on-one interview.
Questionnaires and surveys. Questionnaires and surveys are written
sets of questions designed to quickly accumulate information from a
large number of respondents. Questionnaires and/or surveys are most
appropriate with varied audiences, when a quick turnaround is needed,
when respondents are geographically dispersed, and where statistical
analysis could be appropriate.
Benchmarking. Described in Section 8.1.2.2. Benchmarking involves
comparing actual or planned products, processes, and practices to
those of comparable organizations to identify best practices, generate
ideas for improvement, and provide a basis for measuring
performance. The organizations compared during benchmarking can
be internal or external.
5.2.2.3 DATA ANALYSIS
Described in Section 4.5.2.2. Data analysis techniques that can be used for this
process include but are not limited to document analysis. Document analysis
consists of reviewing and assessing any relevant documented information. In this
process, document analysis is used to elicit requirements by analyzing existing
documentation and identifying information relevant to the requirements. There is
a wide range of documents that may be analyzed to help elicit relevant
requirements. Examples of documents that may be analyzed include but are not
limited to:
Agreements;
Business plans;
Business process or interface documentation;
Business rules repositories;
Current process flows;
Marketing literature;
Problem/issue logs;
Policies and procedures;
Regulatory documentation such as laws, codes, or ordinances, etc.;
Requests for proposal; and
Use cases.
5.2.2.4 DECISION MAKING
Decision-making techniques that can be used in the Collect Requirements
process include but are not limited to:
Voting. Voting is a collective decision-making technique and an
assessment process having multiple alternatives with an expected
outcome in the form of future actions. These techniques can be used to
generate, classify, and prioritize product requirements. Examples of
voting techniques include:
Unanimity. A decision that is reached whereby everyone agrees on a
single course of action.
Majority. A decision that is reached with support obtained from more
than 50% of the members of the group. Having a group size with an
uneven number of participants can ensure that a decision will be
reached, rather than resulting in a tie.
Plurality. A decision that is reached whereby the largest block in a
group decides, even if a majority is not achieved. This method is
generally used when the number of options nominated is more than
two.
Autocratic decision making. In this method, one individual takes
responsibility for making the decision for the group.
Multicriteria decision analysis. A technique that uses a decision matrix
to provide a systematic analytical approach for establishing criteria,
such as risk levels, uncertainty, and valuation, to evaluate and rank
many ideas.
5.2.2.5 DATA REPRESENTATION
Data representation techniques that can be used for this process include but
are not limited to:
Affinity diagrams. Affinity diagrams allow large numbers of ideas to
be classified into groups for review and analysis.
Mind mapping. Mind mapping consolidates ideas created through
individual brainstorming sessions into a single map to reflect
commonality and differences in understanding and to generate new
ideas.
5.2.2.6 INTERPERSONAL AND TEAM SKILLS
Described in Section 4.1.2.3. The interpersonal and team skills that can be
used in this process include but are not limited to:
Nominal group technique. The nominal group technique enhances
brainstorming with a voting process used to rank the most useful ideas
for further brainstorming or for prioritization. The nominal group
technique is a structured form of brainstorming consisting of four
steps:
A question or problem is posed to the group. Each person silently
generates and writes down their ideas.
The moderator writes down the ideas on a flip chart until all ideas are
recorded.
Each recorded idea is discussed until all group members have a clear
understanding.
Individuals vote privately to prioritize the ideas, usually using a scale
of 1 – 5, with 1 being the lowest and 5 being the highest. Voting may
take place in many rounds to reduce and focus in on ideas. After each
round, the votes are tallied and the highest scoring ideas are selected.
Observation/conversation. Observation and conversation provide a
direct way of viewing individuals in their environment and how they
perform their jobs or tasks and carry out processes. It is particularly
helpful for detailed processes when the people who use the product
have difficulty or are reluctant to articulate their requirements.
Observation is also known as “job shadowing.” It is usually done
externally by an observer viewing a business expert performing a job.
It can also be done by a “participant observer” who actually performs a
process or procedure to experience how it is done to uncover hidden
requirements.
Facilitation. Described in Section 4.1.2.3. Facilitation is used with
focused sessions that bring key stakeholders together to define product
requirements. Workshops can be used to quickly define cross-
functional requirements and reconcile stakeholder differences.
Because of their interactive group nature, well-facilitated sessions can
build trust, foster relationships, and improve communication among
the participants, which can lead to increased stakeholder consensus. In
addition, issues can be discovered earlier and resolved more quickly
than in individual sessions.
Facilitation skills are used in the following situations, but are not limited to:
Joint application design/development (JAD). JAD sessions are used
in the software development industry. These facilitated sessions focus
on bringing business subject matter experts and the development
team together to gather requirements and improve the software
development process.
Quality function deployment (QFD). In the manufacturing industry,
QFD is another facilitation technique that helps determine critical
characteristics for new product development. QFD starts by
collecting customer needs, also known as voice of the customer
(VOC). These needs are then objectively sorted and prioritized, and
goals are set for achieving them.
User stories. User stories, which are short, textual descriptions of
required functionality, are often developed during a requirements
workshop. User stories describe the stakeholder role, who benefits
from the feature (role), what the stakeholder needs to accomplish
(goal), and the benefit to the stakeholder (motivation).
5.2.2.7 CONTEXT DIAGRAM
The context diagram is an example of a scope model. Context diagrams
visually depict the product scope by showing a business system (process,
equipment, computer system, etc.), and how people and other systems (actors)
interact with it (see Figure 5-6). Context diagrams show inputs to the business
system, the actor(s) providing the input, the outputs from the business system,
and the actor(s) receiving the output.
5.2.2.8 PROTOTYPES
Prototyping is a method of obtaining early feedback on requirements by
providing a model of the expected product before actually building it. Examples
of prototypes are small-scale products, computer generated 2D and 3D models,
mock-ups, or simulations. Prototypes allow stakeholders to experiment with a
model of the final product rather than being limited to discussing abstract
representations of their requirements. Prototypes support the concept of
progressive elaboration in iterative cycles of mock-up creation, user
experimentation, feedback generation, and prototype revision. When enough
feedback cycles have been performed, the requirements obtained from the
prototype are sufficiently complete to move to a design or build phase.
Storyboarding is a prototyping technique showing sequence or navigation
through a series of images or illustrations. Storyboards are used on a variety of
projects in a variety of industries, such as film, advertising, instructional design,
and on agile and other software development projects. In software development,
storyboards use mock-ups to show navigation paths through web pages, screens,
or other user interfaces.
5.2.3 COLLECT REQUIREMENTS: OUTPUTS
5.2.3.1 REQUIREMENTS DOCUMENTATION
Requirements documentation describes how individual requirements meet the
business need for the project. Requirements may start out at a high level and
become progressively more detailed as more information about the requirements
is known. Before being baselined, requirements need to be unambiguous
(measurable and testable), traceable, complete, consistent, and acceptable to key
stakeholders. The format of the requirements document may range from a simple
document listing all the requirements categorized by stakeholder and priority, to
more elaborate forms containing an executive summary, detailed descriptions,
and attachments.
Many organizations categorize requirements into different types, such as
business and technical solutions, the former referring to stakeholder needs and
the latter as to how those needs will be implemented. Requirements can be
grouped into classifications allowing for further refinement and detail as the
requirements are elaborated. These classifications include:
Business requirements. These describe the higher-level needs of the
organization as a whole, such as the business issues or opportunities,
and reasons why a project has been undertaken.
Stakeholder requirements. These describe needs of a stakeholder or
stakeholder group.
Solution requirements. These describe features, functions, and
characteristics of the product, service, or result that will meet the
business and stakeholder requirements. Solution requirements are
further grouped into functional and nonfunctional requirements:
Functional requirements. Functional requirements describe the
behaviors of the product. Examples include actions, processes, data,
and interactions that the product should execute.
Nonfunctional requirements. Nonfunctional requirements
supplement functional requirements and describe the environmental
conditions or qualities required for the product to be effective.
Examples include: reliability, security, performance, safety, level of
service, supportability, retention/purge, etc.
Transition and readiness requirements. These describe temporary
capabilities, such as data conversion and training requirements, needed
to transition from the current as-is state to the desired future state.
Project requirements. These describe the actions, processes, or other
conditions the project needs to meet. Examples include milestone
dates, contractual obligations, constraints, etc.
Quality requirements. These capture any condition or criteria needed
to validate the successful completion of a project deliverable or
fulfillment of other project requirements. Examples include tests,
certifications, validations, etc.
5.2.3.2 REQUIREMENTS TRACEABILITY MATRIX
The requirements traceability matrix is a grid that links product requirements
from their origin to the deliverables that satisfy them. The implementation of a
requirements traceability matrix helps ensure that each requirement adds
business value by linking it to the business and project objectives. It provides a
means to track requirements throughout the project life cycle, helping to ensure
that requirements approved in the requirements documentation are delivered at
the end of the project. Finally, it provides a structure for managing changes to
the product scope.
Tracing requirements includes but is not limited to:
Business needs, opportunities, goals, and objectives;
Project objectives;
Project scope and WBS deliverables;
Product design;
Product development;
Test strategy and test scenarios; and
High-level requirements to more detailed requirements.
Attributes associated with each requirement can be recorded in the
requirements traceability matrix. These attributes help to define key information
about the requirement. Typical attributes used in the requirements traceability
matrix may include: a unique identifier, a textual description of the requirement,
the rationale for inclusion, owner, source, priority, version, current status (such
as active, cancelled, deferred, added, approved, assigned, completed), and status
date. Additional attributes to ensure that the requirement has met stakeholders’
satisfaction may include stability, complexity, and acceptance criteria. Figure 5-
7 provides an example of a requirements traceability matrix with its associated
attributes.
5.3 DEFINE SCOPE
Define Scope is the process of developing a detailed description of the project
and product. The key benefit of this process is that it describes the product,
service, or result boundaries and acceptance criteria. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 5-8. Figure 5-9
depicts the data flow diagram of the process.
Since all the requirements identified in Collect Requirements may not be
included in the project, the Define Scope process selects the final project
requirements from the requirements documentation developed during the Collect
Requirements process. It then develops a detailed description of the project and
product, service, or result.
The preparation of a detailed project scope statement builds upon the major
deliverables, assumptions, and constraints that are documented during project
initiation. During project planning, the project scope is defined and described
with greater specificity as more information about the project is known. Existing
risks, assumptions, and constraints are analyzed for completeness and added or
updated as necessary. The Define Scope process can be highly iterative. In
iterative life cycle projects, a high-level vision will be developed for the overall
project, but the detailed scope is determined one iteration at a time, and the
detailed planning for the next iteration is carried out as work progresses on the
current project scope and deliverables.
5.3.1 DEFINE SCOPE: INPUTS
5.3.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter provides the high-level
project description, product characteristics, and approval requirements.
5.3.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. A project management plan component includes
but is not limited to the scope management plan as described in Section 5.1.3.1,
which documents how the project scope will be defined, validated, and
controlled.
5.3.1.3 PROJECT DOCUMENTS
Examples of project documents that can be considered as inputs for this
process include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log
identifies assumptions and constraints about the product, project,
environment, stakeholders, and other factors that can influence the
project and product scope.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation identifies requirements that will be
incorporated into the scope.
Risk register. Described in Section 11.2.3.1. The risk register contains
response strategies that may affect the project scope, such as reducing
or changing project and product scope to avoid or mitigate a risk.
5.3.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Define Scope
process include but are not limited to:
Organization's culture,
Infrastructure,
Personnel administration, and
Marketplace conditions.
5.3.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Define Scope process
include but are not limited to:
Policies, procedures, and templates for a project scope statement;
Project files from previous projects; and
Lessons learned from previous phases or projects.
5.3.2 DEFINE SCOPE: TOOLS AND TECHNIQUES
5.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with knowledge of or experience with similar projects.
5.3.2.2 DATA ANALYSIS
An example of a data analysis technique that can be used in this process
includes but is not limited to alternatives analysis. Alternatives analysis can be
used to evaluate ways to meet the requirements and the objectives identified in
the charter.
5.3.2.3 DECISION MAKING
Described in Section 5.1.2.2. A decision-making technique that can be used in
this process includes but is not limited to multicriteria decision analysis.
Described in Section 8.1.2.4, multicriteria decision analysis is a technique that
uses a decision matrix to provide a systematic analytical approach for
establishing criteria, such as requirements, schedule, budget, and resources, in
order to refine the project and product scope for the project.
5.3.2.4 INTERPERSONAL AND TEAM SKILLS
Described in Section 4.1.2.3. An example of an interpersonal and team skills
technique is facilitation. Facilitation is used in workshops and working sessions
with key stakeholders who have a variety of expectations or fields of expertise.
The goal is to reach a cross-functional and common understanding of the project
deliverables and project and product boundaries.
5.3.2.5 PRODUCT ANALYSIS
Product analysis can be used to define products and services. It includes
asking questions about a product or service and forming answers to describe the
use, characteristics, and other relevant aspects of what is going to be delivered.
Each application area has one or more generally accepted methods for
translating high-level product or service descriptions into meaningful
deliverables. Requirements are captured at a high level and decomposed to the
level of detail needed to design the final product. Examples of product analysis
techniques include but are not limited to:
Product breakdown,
Requirements analysis,
Systems analysis,
Systems engineering,
Value analysis, and
Value engineering.
5.3.3 DEFINE SCOPE: OUTPUTS
5.3.3.1 PROJECT SCOPE STATEMENT
The project scope statement is the description of the project scope, major
deliverables, assumptions, and constraints. The project scope statement
documents the entire scope, including project and product scope. It describes the
project's deliverables in detail. It also provides a common understanding of the
project scope among project stakeholders. It may contain explicit scope
exclusions that can assist in managing stakeholder expectations. It enables the
project team to perform more detailed planning, guides the project team's work
during execution, and provides the baseline for evaluating whether requests for
changes or additional work are contained within or outside the project's
boundaries.
The degree and level of detail to which the project scope statement defines the
work that will be performed and the work that is excluded can help determine
how well the project management team can control the overall project scope.
The detailed project scope statement, either directly or by reference to other
documents, includes the following:
Product scope description. Progressively elaborates the characteristics
of the product, service, or result described in the project charter and
requirements documentation.
Deliverables. Any unique and verifiable product, result, or capability
to perform a service that is required to be produced to complete a
process, phase, or project. Deliverables also include ancillary results,
such as project management reports and documentation. These
deliverables may be described at a summary level or in great detail.
Acceptance criteria. A set of conditions that is required to be met
before deliverables are accepted.
Project exclusions. Identifies what is excluded from the project.
Explicitly stating what is out of scope for the project helps manage
stakeholders’ expectations and can reduce scope creep.
Although the project charter and the project scope statement are sometimes
perceived as containing a certain degree of redundancy, they are different in the
level of detail contained in each. The project charter contains high-level
information, while the project scope statement contains a detailed description of
the scope components. These components are progressively elaborated
throughout the project. Table 5-1 describes some of the key elements for each
document.
5.3.3.2 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log is
updated with additional assumptions or constraints that were identified
during this process.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may be updated with additional or
changed requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix may be updated to reflect updates in
requirement documentation.
Stakeholder register. Described in Section 13.1.3.1. Where additional
information on existing or new stakeholders is gathered as a result of
this process, it is recorded in the stakeholder register.
5.4 CREATE WBS
Create WBS is the process of subdividing project deliverables and project
work into smaller, more manageable components. The key benefit of this
process is that it provides a framework of what has to be delivered. This process
is performed once or at predefined points in the project. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 5-10. Figure 5-11
depicts the data flow diagram of the process.
The WBS is a hierarchical decomposition of the total scope of work to be
carried out by the project team to accomplish the project objectives and create
the required deliverables. The WBS organizes and defines the total scope of the
project and represents the work specified in the current approved project scope
statement.
The planned work is contained within the lowest level of WBS components,
which are called work packages. A work package can be used to group the
activities where work is scheduled and estimated, monitored, and controlled. In
the context of the WBS, work refers to work products or deliverables that are the
result of activity and not to the activity itself.
5.4.1 CREATE WBS: INPUTS
5.4.1.1 PROJECT MANAGEMENT PLAN
A project management plan component includes but is not limited to the scope
management plan. Described in Section 5.1.3.1, the scope management plan
documents how the WBS will be created from the project scope statement.
5.4.1.2 PROJECT DOCUMENTS
Examples of project documents that can be considered as inputs for this
process include but are not limited to:
Project scope statement. Described in Section 5.3.3.1. The project
scope statement describes the work that will be performed and the
work that is excluded.
Requirements documentation. Described in Section 5.2.3.1. Detailed
requirements describe how individual requirements meet the business
need for the project.
5.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Create WBS
process include but are not limited to industry-specific WBS standards that are
relevant to the nature of the project. These industry-specific standards may serve
as external reference sources for creating the WBS.
5.4.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Create WBS process
include but are not limited to:
Policies, procedures, and templates for the WBS;
Project files from previous projects; and
Lessons learned from previous projects.
5.4.2 CREATE WBS: TOOLS AND TECHNIQUES
5.4.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with knowledge of or experience with similar projects.
5.4.2.2 DECOMPOSITION
Decomposition is a technique used for dividing and subdividing the project
scope and project deliverables into smaller, more manageable parts. The work
package is the work defined at the lowest level of the WBS for which cost and
duration can be estimated and managed. The level of decomposition is often
guided by the degree of control needed to effectively manage the project. The
level of detail for work packages will vary with the size and complexity of the
project. Decomposition of the total project work into work packages generally
involves the following activities:
Identifying and analyzing the deliverables and related work,
Structuring and organizing the WBS,
Decomposing the upper WBS levels into lower-level detailed
components,
Developing and assigning identification codes to the WBS
components, and
Verifying that the degree of decomposition of the deliverables is
appropriate.
A portion of a WBS with some branches of the WBS decomposed down
through the work package level is shown in Figure 5-12.
A WBS structure may be created through various approaches. Some of the
popular methods include the top-down approach, the use of organization-specific
guidelines, and the use of WBS templates. A bottom-up approach can be used to
group subcomponents. The WBS structure can be represented in a number of
forms, such as:
Using phases of the project life cycle as the second level of
decomposition, with the product and project deliverables inserted at
the third level, as shown in Figure 5-13;
Using major deliverables as the second level of decomposition, as
shown in Figure 5-14; and
Incorporating subcomponents that may be developed by organizations
outside the project team, such as contracted work. The seller then
develops the supporting contract WBS as part of the contracted work.
Decomposition of the upper-level WBS components requires subdividing the
work for each of the deliverables or subcomponents into its most fundamental
components, where the WBS components represent verifiable products, services,
or results. If an agile approach is used, epics can be decomposed into user
stories. The WBS may be structured as an outline, an organizational chart, or
other method that identifies a hierarchical breakdown. Verifying the correctness
of the decomposition requires determining that the lower-level WBS
components are those that are necessary and sufficient for completion of the
corresponding higher-level deliverables. Different deliverables can have
different levels of decomposition. To arrive at a work package, the work for
some deliverables needs to be decomposed only to the next level, while others
need additional levels of decomposition. As the work is decomposed to greater
levels of detail, the ability to plan, manage, and control the work is enhanced.
However, excessive decomposition can lead to nonproductive management
effort, inefficient use of resources, decreased efficiency in performing the work,
and difficulty aggregating data over different levels of the WBS.
Decomposition may not be possible for a deliverable or subcomponent that
will be accomplished far into the future. The project management team usually
waits until the deliverable or subcomponent is agreed on, so the details of the
WBS can be developed. This technique is sometimes referred to as rolling wave
planning.
The WBS represents all product and project work, including the project
management work. The total of the work at the lowest levels should roll up to
the higher levels so that nothing is left out and no extra work is performed. This
is sometimes called the 100 percent rule.
For specific information regarding the WBS, refer to the Practice Standard
for Work Breakdown Structures – Second Edition [15]. This standard contains
industry-specific examples of WBS templates that can be tailored to specific
projects in a particular application area.
5.4.3 CREATE WBS: OUTPUTS
5.4.3.1 SCOPE BASELINE
The scope baseline is the approved version of a scope statement, WBS, and its
associated WBS dictionary, which can be changed only through formal change
control procedures and is used as a basis for comparison. It is a component of the
project management plan. Components of the scope baseline include:
Project scope statement. The project scope statement includes the
description of the project scope, major deliverables, assumptions, and
constraints (Section 5.3.3.1).
WBS. The WBS is a hierarchical decomposition of the total scope of
work to be carried out by the project team to accomplish the project
objectives and create the required deliverables. Each descending level
of the WBS represents an increasingly detailed definition of the project
work.
Work package. The lowest level of the WBS is a work package with a
unique identifier. These identifiers provide a structure for hierarchical
summation of costs, schedule, and resource information and form a
code of accounts. Each work package is part of a control account. A
control account is a management control point where scope, budget,
and schedule are integrated and compared to the earned value for
performance measurement. A control account has two or more work
packages, though each work package is associated with a single
control account.
Planning package. A control account may include one or more
planning packages. A planning package is a work breakdown structure
component below the control account and above the work package
with known work content but without detailed schedule activities.
WBS dictionary. The WBS dictionary is a document that provides
detailed deliverable, activity, and scheduling information about each
component in the WBS. The WBS dictionary is a document that
supports the WBS. Most of the information included in the WBS
dictionary is created by other processes and added to this document at
a later stage. Information in the WBS dictionary may include but is not
limited to:
Code of account identifier,
Description of work,
Assumptions and constraints,
Responsible organization,
Schedule milestones,
Associated schedule activities,
Resources required,
Cost estimates,
Quality requirements,
Acceptance criteria,
Technical references, and
Agreement information.
5.4.3.2 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log is
updated with additional assumptions or constraints that were identified
during the Create WBS process.
Requirements documentation. Described in Section 5.2.3.1. Requirements
documentation may be updated to include approved changes resulting from
the Create WBS process.
5.5 VALIDATE SCOPE
Validate Scope is the process of formalizing acceptance of the completed
project deliverables. The key benefit of this process is that it brings objectivity to
the acceptance process and increases the probability of final product, service, or
result acceptance by validating each deliverable. This process is performed
periodically throughout the project as needed. The inputs, tools and techniques,
and outputs of this process are depicted in Figure 5-15. Figure 5-16 depicts the
data flow diagram of the process.
The verified deliverables obtained from the Control Quality process are
reviewed with the customer or sponsor to ensure they are completed
satisfactorily and have received formal acceptance of the deliverables by the
customer or sponsor. In this process, the outputs obtained as a result of the
Planning processes in the Project Scope Management Knowledge Area, such as
the requirements documentation or the scope baseline, as well as the work
performance data obtained from the Execution processes in other Knowledge
Areas, are the basis for performing the validation and for final acceptance.
The Validate Scope process differs from the Control Quality process in that
the former is primarily concerned with acceptance of the deliverables, while the
latter is primarily concerned with correctness of the deliverables and meeting the
quality requirements specified for the deliverables. Control Quality is generally
performed before Validate Scope, although the two processes may be performed
in parallel.
5.5.1 VALIDATE SCOPE: INPUTS
5.5.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The project
management plan specifies how formal acceptance of the completed
project deliverables will be obtained.
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan describes how the project requirements
are validated.
Scope baseline. Described in Section 5.4.3.1. The scope baseline is
compared to actual results to determine if a change, corrective action,
or preventive action is necessary.
5.5.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register: Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve the efficiency and effectiveness of validating deliverables.
Quality reports. Described in Section 8.2.3.1. The information
presented in the quality report may include all quality assurance issues
managed or escalated by the team, recommendations for improvement,
and the summary of findings from the Control Quality process. This
information is reviewed prior to product acceptance.
Requirements documentation. Described in Section 5.2.3.1.
Requirements are compared to the actual results to determine if a
change, corrective action, or preventive action is necessary.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix contains information about
requirements, including how they will be validated.
5.5.1.3 VERIFIED DELIVERABLES
Verified deliverables are project deliverables that are completed and checked
for correctness through the Control Quality process.
5.5.1.4 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data can include the degree
of compliance with requirements, number of nonconformities, severity of the
nonconformities, or the number of validation cycles performed in a period of
time.
5.5.2 VALIDATE SCOPE: TOOLS AND TECHNIQUES
5.5.2.1 INSPECTION
Described in Section 8.3.2.3. Inspection includes activities such as measuring,
examining, and validating to determine whether work and deliverables meet
requirements and product acceptance criteria. Inspections are sometimes called
reviews, product reviews, and walkthroughs. In some application areas, these
different terms have unique and specific meanings.
5.5.2.2 DECISION MAKING
Described in Section 5.2.2.4. An example of decision making that may be
used in this process includes but is not limited to voting. Voting is used to reach
a conclusion when the validation is performed by the project team and other
stakeholders.
5.5.3 VALIDATE SCOPE: OUTPUTS
5.5.3.1 ACCEPTED DELIVERABLES
Deliverables that meet the acceptance criteria are formally signed off and
approved by the customer or sponsor. Formal documentation received from the
customer or sponsor acknowledging formal stakeholder acceptance of the
project's deliverables is forwarded to the Close Project or Phase process (Section
4.7).
5.5.3.2 WORK PERFORMANCE INFORMATION
Work performance information includes information about project progress,
such as which deliverables have been accepted and which have not been
accepted and the reasons why. This information is documented as described in
Section 10.3.3.1 and communicated to stakeholders.
5.5.3.3 CHANGE REQUESTS
The completed deliverables that have not been formally accepted are
documented, along with the reasons for non-acceptance of those deliverables.
Those deliverables may require a change request for defect repair. The change
requests (described in Section 4.3.3.4) are processed for review and disposition
through the Perform Integrated Change Control process (Section 4.6).
5.5.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well for validating deliverables.
Requirements documentation. Described in Section 5.2.3.1. The
requirements documentation may be updated with the actual results of
validation activity. Of particular interest is when the actual results are
better than the requirement or where a requirement was waived.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix is updated with the results of the
validation, including the method used and the outcome.
5.6 CONTROL SCOPE
Control Scope is the process of monitoring the status of the project and
product scope and managing changes to the scope baseline. The key benefit of
this process is that the scope baseline is maintained throughout the project. This
process is performed throughout the project. The inputs, tools and techniques,
and outputs of this process are depicted in Figure 5-17. Figure 5-18 depicts the
data flow diagram of the process.
Controlling the project scope ensures all requested changes and recommended
corrective or preventive actions are processed through the Perform Integrated
Change Control process (see Section 4.6). Control Scope is also used to manage
the actual changes when they occur and is integrated with the other control
processes. The uncontrolled expansion to product or project scope without
adjustments to time, cost, and resources is referred to as scope creep. Change is
inevitable; therefore, some type of change control process is mandatory for every
project.
5.6.1 CONTROL SCOPE: INPUTS
5.6.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan documents how the project and product scope will
be controlled.
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan describes how the project requirements
will be managed.
Change management plan. Described in Section 4.2.3.1. The change
management plan defines the process for managing change on the
project.
Configuration management plan. Described in Section 4.2.3.1. The
configuration management plan defines those items that are
configurable, those items that require formal change control, and the
process for controlling changes to such items.
Scope baseline. Described in Section 5.4.3.1. The scope baseline is
compared to actual results to determine if a change, corrective action,
or preventive action is necessary.
Performance measurement baseline. Described in Section 4.2.3.1.
When using earned value analysis, the performance measurement
baseline is compared to actual results to determine if a change,
corrective action, or preventive action is necessary.
5.6.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve scope control.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation is used to detect any deviation in the
agreed-upon scope for the project or product.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix helps to detect the impact of any
change or deviation from the scope baseline on the project objectives.
It may also provide status of requirements being controlled.
5.6.1.3 WORK PERFORMANCE DATA
Work performance data can include the number of change requests received,
the number of requests accepted, and the number of deliverables verified,
validated, and completed.
5.6.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Scope process
include but are not limited to:
Existing formal and informal scope, control-related policies,
procedures, guidelines; and
Monitoring and reporting methods and templates to be used.
5.6.2 CONTROL SCOPE: TOOLS AND TECHNIQUES
5.6.2.1 DATA ANALYSIS
Data analysis techniques that can be used in the Control Scope process include
but are not limited to:
Variance analysis. Described in Section 4.5.2.2. Variance analysis is
used to compare the baseline to the actual results and determine if the
variance is within the threshold amount or if corrective or preventive
action is appropriate.
Trend analysis. Described in Section 4.5.2.2. Trend analysis examines
project performance over time to determine if performance is
improving or deteriorating.
Important aspects of project scope control include determining the cause and
degree of variance relative to the scope baseline (Section 5.4.3.1) and deciding
whether corrective or preventive action is required.
5.6.3 CONTROL SCOPE: OUTPUTS
5.6.3.1 WORK PERFORMANCE INFORMATION
Work performance information produced includes correlated and
contextualized information on how the project and product scope are performing
compared to the scope baseline. It can include the categories of the changes
received, the identified scope variances and their causes, how they impact
schedule or cost, and the forecast of the future scope performance.
5.6.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. Analysis of project performance may result in a
change request to the scope and schedule baselines or other components of the
project management plan. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
5.6.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan may be updated to reflect a change in how the scope
is managed.
Scope baseline. Described in Section 5.4.3.1. Changes to the scope
baseline are incorporated in response to approved changes in scope,
scope statement, the WBS, or the WBS dictionary. In some cases,
scope variances can be so severe that a revised scope baseline is
needed to provide a realistic basis for performance measurement.
Schedule baseline. Described in Section 6.5.3.1. Changes to the
schedule baseline are incorporated in response to approved changes in
scope, resources, or schedule estimates. In some cases, schedule
variances can be so severe that a revised schedule baseline is needed to
provide a realistic basis for performance measurement.
Cost baseline. Described in Section 7.3.3.1. Changes to the cost
baseline are incorporated in response to approved changes in scope,
resources, or cost estimates. In some cases, cost variances can be so
severe that a revised cost baseline is needed to provide a realistic basis
for performance measurement.
Performance measurement baseline. Described in Section 4.2.3.1.
Changes to the performance measurement baseline are incorporated in
response to approved changes in scope, schedule performance, or cost
estimates. In some cases, the performance variances can be so severe
that a change request is put forth to revise the performance
measurement baseline to provide a realistic basis for performance
measurement.
5.6.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that are efficient and
effective in controlling scope, including causes of variances and
corrective actions chosen.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may be updated with additional or
changed requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix may be updated to reflect updates in
requirement documentation.
6
PROJECT SCHEDULE MANAGEMENT
Project Schedule Management includes the processes required to manage the
timely completion of the project. The Project Schedule Management processes
are:
6.1 Plan Schedule Management—The process of establishing the policies,
procedures, and documentation for planning, developing, managing, executing,
and controlling the project schedule.
6.2 Define Activities—The process of identifying and documenting the
specific actions to be performed to produce the project deliverables.
6.3 Sequence Activities—The process of identifying and documenting
relationships among the project activities.
6.4 Estimate Activity Durations—The process of estimating the number of
work periods needed to complete individual activities with the estimated
resources.
6.5 Develop Schedule—The process of analyzing activity sequences,
durations, resource requirements, and schedule constraints to create the project
schedule model for project execution and monitoring and controlling.
6.6 Control Schedule—The process of monitoring the status of the project to
update the project schedule and manage changes to the schedule baseline.
Figure 6-1 provides an overview of the Project Schedule Management
processes. The Project Schedule Management processes are presented as discrete
processes with defined interfaces while, in practice, they overlap and interact in
ways that cannot be completely detailed in the PMBOK® Guide.
KEY CONCEPTS FOR PROJECT SCHEDULE MANAGEMENT
Project scheduling provides a detailed plan that represents how and when the
project will deliver the products, services, and results defined in the project
scope and serves as a tool for communication, managing stakeholders’
expectations, and as a basis for performance reporting.
The project management team selects a scheduling method, such as critical
path or an agile approach. Then, the project-specific data, such as the activities,
planned dates, durations, resources, dependencies, and constraints, are entered
into a scheduling tool to create a schedule model for the project. The result is a
project schedule. Figure 6-2 provides a scheduling overview that shows how the
scheduling method, scheduling tool, and outputs from the Project Schedule
Management processes interact to create a schedule model.
For smaller projects, defining activities, sequencing activities, estimating
activity durations, and developing the schedule model are so tightly linked that
they are viewed as a single process that can be performed by a person over a
relatively short period of time. These processes are presented here as distinct
elements because the tools and techniques for each process are different. Some
of these processes are presented more fully in the Practice Standard for
Scheduling [2].
When possible, the detailed project schedule should remain flexible
throughout the project to adjust for knowledge gained, increased understanding
of the risk, and value-added activities.
TRENDS AND EMERGING PRACTICES IN PROJECT SCHEDULE
MANAGEMENT
With high levels of uncertainty and unpredictability in a fast-paced, highly
competitive global marketplace where long term scope is difficult to define, it is
becoming even more important to have a contextual framework for effective
adoption and tailoring of development practices to respond to the changing
needs of the environment. Adaptive planning defines a plan but acknowledges
that once work starts, the priorities may change and the plan needs to reflect this
new knowledge.
Some of the emerging practices for project scheduling methods include but
are not limited to:
Alterative scheduling with a backlog. This is a form of rolling wave
planning based on adaptive life cycles, such as the agile approach for
product development. The requirements are documented in user stories
that are then prioritized and refined just prior to construction, and the
product features are developed using time-boxed periods of work. This
approach is often used to deliver incremental value to the customer or
when multiple teams can concurrently develop a large number of
features that have few interconnected dependencies. This scheduling
method is appropriate for many projects as indicated by the
widespread and growing use of adaptive life cycles for product
development. The benefit of this approach is that it welcomes changes
throughout the development life cycle.
On-demand scheduling. This approach, typically used in a Kanban
system, is based on the theory-of-constraints and pull-based
scheduling concepts from lean manufacturing to limit a team's work in
progress in order to balance demand against the team's delivery
throughput. On-demand scheduling does not rely on a schedule that
was developed previously for the development of the product or
product increments, but rather pulls work from a backlog or
intermediate queue of work to be done immediately as resources
become available. On-demand scheduling is often used for projects
that evolve the product incrementally in operational or sustainment
environments, and where tasks may be made relatively similar in size
and scope or can be bundled by size and scope.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager may need to tailor the
way Project Schedule Management processes are applied. Considerations for
tailoring include but are not limited to:
Life cycle approach. What is the most appropriate life cycle approach
that allows for a more detailed schedule?
Resource availability. What are the factors influencing durations (such
as the correlation between available resources and their productivity)?
Project dimensions. How will the presence of project complexity,
technological uncertainty, product novelty, pace, or progress tracking
(such as earned value, percentage complete, red-yellow-green (stop
light) indicators) impact the desired level of control?
Technology support. Is technology used to develop, record, transmit,
receive, and store project schedule model information and is it readily
accessible?
For more specific information regarding scheduling, refer to the Practice
Standard for Scheduling [16].
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Adaptive approaches use short cycles to undertake work, review the results,
and adapt as necessary. These cycles provide rapid feedback on the approaches
and suitability of deliverables, and generally manifest as iterative scheduling and
on-demand, pull-based scheduling, as discussed in the section on Key Trends
and Emerging Practices in Project Schedule Management.
In large organizations, there may be a mixture of small projects and large
initiatives requiring long-term roadmaps to manage the development of these
programs using scaling factors (e.g., team size, geographical distribution,
regulatory compliance, organizational complexity, and technical complexity). To
address the full delivery life cycle for larger, enterprise-wide systems, a range of
techniques utilizing a predictive approach, adaptive approach, or a hybrid of
both, may need to be adopted. The organization may need to combine practices
from several core methods, or adopt a method that has already done so, and
adopt a few principles and practices of more traditional techniques.
The role of the project manager does not change based on managing projects
using a predictive development life cycle or managing projects in adaptive
environments. However, to be successful in using adaptive approaches, the
project manager will need to be familiar with the tools and techniques to
understand how to apply them effectively.
6.1 PLAN SCHEDULE MANAGEMENT
Plan Schedule Management is the process of establishing the policies,
procedures, and documentation for planning, developing, managing, executing,
and controlling the project schedule. The key benefit of this process is that it
provides guidance and direction on how the project schedule will be managed
throughout the project. This process is performed once or at predefined points in
the project. The inputs, tools and techniques, and outputs of the process are
depicted in Figure 6-3. Figure 6-4 depicts the data flow diagram for the process.
6.1.1 PLAN SCHEDULE MANAGEMENT: INPUTS
6.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter defines the summary
milestone schedule that will influence the management of the project schedule.
6.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.3.2.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan describes how the scope will be defined and
developed, which will provide information on how the schedule will
be developed.
Development approach. Described in Section 4.2.3.1. The product
development approach will help define the scheduling approach,
estimating techniques, scheduling tools, and techniques for controlling
the schedule.
6.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Schedule
Management process include but are not limited to:
Organizational culture and structure,
Team resource availability and skills and physical resource
availability,
Scheduling software,
Guidelines and criteria for tailoring the organization's set of standard
processes and procedures to satisfy the specific needs of the project,
and
Commercial databases, such as standardized estimating data.
6.1.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Schedule
Management process include but are not limited to:
Historical information and lessons learned repositories;
Existing formal and informal schedule development, management- and
control-related policies, procedures, and guidelines;
Templates and forms; and
Monitoring and reporting tools.
6.1.2 PLAN SCHEDULE MANAGEMENT: TOOLS AND
TECHNIQUES
6.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in previous, similar projects:
Schedule development, management, and control;
Scheduling methodologies (e.g., predictive or adaptive life cycle);
Scheduling software; and
The specific industry for which the project is developed.
6.1.2.2 DATA ANALYSIS
A data analysis technique that can be used for this process includes but is not
limited to alternatives analysis. Alternatives analysis can include determining
which schedule methodology to use, or how to combine various methods on the
project. It can also include determining how detailed the schedule needs to be,
the duration of waves for rolling wave planning, and how often it should be
reviewed and updated. An appropriate balance between the level of detail needed
to manage the schedule and the amount of time it takes to keep it up to date
needs to be reached for each project.
6.1.2.3 MEETINGS
Project teams may hold planning meetings to develop the schedule
management plan. Participants at these meetings may include the project
manager, the project sponsor, selected project team members, selected
stakeholders, anyone with responsibility for schedule planning or execution, and
others as needed.
6.1.3 PLAN SCHEDULE MANAGEMENT: OUTPUTS
6.1.3.1 SCHEDULE MANAGEMENT PLAN
The schedule management plan is a component of the project management
plan that establishes the criteria and the activities for developing, monitoring,
and controlling the schedule. The schedule management plan may be formal or
informal, highly detailed, or broadly framed based on the needs of the project,
and includes appropriate control thresholds.
The schedule management plan can establish the following:
Project schedule model development. The scheduling methodology
and the scheduling tool to be used in the development of the project
schedule model are specified.
Release and iteration length. When using an adaptive life cycle, the
time-boxed periods for releases, waves, and iterations are specified.
Time-boxed periods are durations during which the team works
steadily toward completion of a goal. Time-boxing helps to minimize
scope creep as it forces the teams to process essential features first,
then other features when time permits.
Level of accuracy. The level of accuracy specifies the acceptable range
used in determining realistic activity duration estimates and may
include an amount for contingencies.
Units of measure. Each unit of measurement (such as staff hours, staff
days, or weeks for time measures, or meters, liters, tons, kilometers, or
cubic yards for quantity measures) is defined for each of the resources.
Organizational procedures links. The work breakdown structure
(WBS) (Section 5.4) provides the framework for the schedule
management plan, allowing for consistency with the estimates and
resulting schedules.
Project schedule model maintenance. The process used to update the
status and record progress of the project in the schedule model during
the execution of the project is defined.
Control thresholds. Variance thresholds for monitoring schedule
performance may be specified to indicate an agreed-upon amount of
variation to be allowed before some action needs to be taken.
Thresholds are typically expressed as percentage deviations from the
parameters established in the baseline plan.
Rules of performance measurement. Earned value management (EVM)
rules or other physical measurement rules of performance
measurement are set. For example, the schedule management plan may
specify:
Rules for establishing percent complete,
EVM techniques (e.g., baselines, fixed-formula, percent complete,
etc.) to be employed (for more specific information, refer to the
Practice Standard for Earned Value Management [17]), and
Schedule performance measurements such as schedule variance (SV)
and schedule performance index (SPI) used to assess the magnitude
of variation to the original schedule baseline.
Reporting formats. The formats and frequency for the various schedule
reports are defined.
6.2 DEFINE ACTIVITIES
Define Activities is the process of identifying and documenting the specific
actions to be performed to produce the project deliverables. The key benefit of
this process is that it decomposes work packages into schedule activities that
provide a basis for estimating, scheduling, executing, monitoring, and
controlling the project work. This process is performed throughout the project.
The inputs, tools and techniques, and outputs of this process are depicted in
Figure 6-5. Figure 6-6 depicts the data flow diagram of the process.
6.2.1 DEFINE ACTIVITIES: INPUTS
6.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan defines the schedule methodology, the
duration of waves for rolling wave planning, and the level of detail
necessary to manage the work.
Scope baseline. Described in Section 5.4.3.1. The project WBS,
deliverables, constraints, and assumptions documented in the scope
baseline are considered explicitly while defining activities.
6.2.1.2 ENTERPRISE ENVIRONMENTAL FACTORS
Enterprise environmental factors that influence the Define Activities process
include but are not limited to:
Organizational cultures and structure,
Published commercial information from commercial databases, and
Project management information system (PMIS).
6.2.1.3 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Define Activities
process include but are not limited to:
Lessons learned repository containing historical information regarding
activity lists used by previous similar projects,
Standardized processes,
Templates that contain a standard activity list or a portion of an
activity list from a previous project, and
Existing formal and informal activity planning-related policies,
procedures, and guidelines, such as the scheduling methodology, that
are considered in developing the activity definitions.
6.2.2 DEFINE ACTIVITIES: TOOLS AND TECHNIQUES
6.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge of similar past projects and the work being
performed.
6.2.2.2 DECOMPOSITION
Described in Section 5.4.2.2. Decomposition is a technique used for dividing
and subdividing the project scope and project deliverables into smaller, more
manageable parts. Activities represent the effort needed to complete a work
package. The Define Activities process defines the final outputs as activities
rather than deliverables, as done in the Create WBS process (Section 5.4).
The activity list, WBS, and WBS dictionary can be developed either
sequentially or concurrently, with the WBS and WBS dictionary used as the
basis for development of the final activity list. Each work package within the
WBS is decomposed into the activities required to produce the work package
deliverables. Involving team members in the decomposition can lead to better
and more accurate results.
6.2.2.3 ROLLING WAVE PLANNING
Rolling wave planning is an iterative planning technique in which the work to
be accomplished in the near term is planned in detail, while work further in the
future is planned at a higher level. It is a form of progressive elaboration
applicable to work packages, planning packages, and release planning when
using an agile or waterfall approach. Therefore, work can exist at various levels
of detail depending on where it is in the project life cycle. During early strategic
planning when information is less defined, work packages may be decomposed
to the known level of detail. As more is known about the upcoming events in the
near term, work packages can be decomposed into activities.
6.2.2.4 MEETINGS
Meetings may be face-to-face, virtual, formal, or informal. Meetings may be
held with team members or subject matter experts to define the activities needed
to complete the work.
6.2.3 DEFINE ACTIVITIES: OUTPUTS
6.2.3.1 ACTIVITY LIST
The activity list includes the schedule activities required on the project. For
projects that use rolling wave planning or agile techniques, the activity list will
be updated periodically as the project progresses. The activity list includes an
activity identifier and a scope of work description for each activity in sufficient
detail to ensure that project team members understand what work is required to
be completed.
6.2.3.2 ACTIVITY ATTRIBUTES
Activity attributes extend the description of the activity by identifying
multiple components associated with each activity. The components for each
activity evolve over time. During the initial stages of the project, they include
the unique activity identifier (ID), WBS ID, and activity label or name. When
completed, they may include activity descriptions, predecessor activities,
successor activities, logical relationships, leads and lags (Section 6.3.2.3),
resource requirements, imposed dates, constraints, and assumptions. Activity
attributes can be used to identify the place where the work has to be performed,
the project calendar the activity is assigned to, and the type of effort involved.
Activity attributes are used for schedule development and for selecting, ordering,
and sorting the planned schedule activities in various ways within reports
6.2.3.3 MILESTONE LIST
A milestone is a significant point or event in a project. A milestone list
identifies all project milestones and indicates whether the milestone is
mandatory, such as those required by contract, or optional, such as those based
on historical information. Milestones have zero duration because they represent
a significant point or event.
6.2.3.4 CHANGE REQUESTS
Described in Section 4.3.3.4. Once the project has been baselined, the
progressive elaboration of deliverables into activities may reveal work that was
not initially part of the project baselines. This may result in a change request.
Change requests are processed for review and disposition through the Perform
Integrated Change Control process (Section 4.6).
6.2.3.5 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Schedule baseline. Described in Section 6.5.3.1. Throughout the
project, work packages are progressively elaborated into activities.
This process may reveal work that was not part of the initial schedule
baseline, necessitating a change to delivery dates or other significant
schedule milestones that are part of the schedule baseline.
Cost baseline. Described in Section 7.3.3.1. Changes to the cost
baseline are incorporated in response to approved changes in schedule
activities.
6.3 SEQUENCE ACTIVITIES
Sequence Activities is the process of identifying and documenting
relationships among the project activities. The key benefit of this process is that
it defines the logical sequence of work to obtain the greatest efficiency given all
project constraints. This process is performed throughout the project. The inputs,
tools and techniques, and outputs of this process are depicted in Figure 6-7.
Figure 6-8 depicts the data flow diagram of the process.
Every activity except the first and last should be connected to at least one
predecessor and at least one successor activity with an appropriate logical
relationship. Logical relationships should be designed to create a realistic project
schedule. It may be necessary to use lead or lag time between activities to
support a realistic and achievable project schedule. Sequencing can be
performed by using project management software or by using manual or
automated techniques. The Sequence Activities process concentrates on
converting the project activities from a list to a diagram to act as a first step to
publish the schedule baseline.
6.3.1 SEQUENCE ACTIVITIES: INPUTS
6.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan defines the method used and the level of
accuracy along with other criteria required to sequence activities.
Scope baseline. Described in Section 5.4.3.1. The project WBS,
deliverables, constraints, and assumptions documented in the scope
baseline are considered explicitly while sequencing activities.
6.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity attributes
may describe a necessary sequence of events or defined predecessor or
successor relationships, as well as defined lead and lag and logical
relationships between the activities.
Activity list. Described in Section 6.2.3.1. The activity list contains all
schedule activities required on the project that are to be sequenced.
Dependencies and other constraints for these activities can influence
the sequencing of the activities.
Assumption log. Described in Section 4.1.3.2. Assumptions and
constraints recorded in the assumption log may influence the way
activities are sequenced, the relationship between activities, and the
need for leads and lags, and may give rise to individual project risks
that may impact the project schedule.
Milestone list. Described in Section 6.2.3.3. The milestone list may
have scheduled dates for specific milestones, which may influence the
way activities are sequenced.
6.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Sequence
Activities process include but are not limited to:
Government or industry standards,
Project management information system (PMIS),
Scheduling tools, and
Organization work authorization systems.
6.3.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Sequence Activities
process include but are not limited to:
Portfolio and program plans and project dependencies and
relationships;
Existing formal and informal activity planning-related policies,
procedures, and guidelines, such as the scheduling methodology that is
considered in developing logical relationships;
Templates that can be used to expedite the preparation of networks for
project activities. Related activity attributes information in templates
can also contain additional descriptive information useful in
sequencing activities; and
Lessons learned repository containing historical information that can
help optimize the sequencing process.
6.3.2 SEQUENCE ACTIVITIES: TOOLS AND TECHNIQUES
6.3.2.1 PRECEDENCE DIAGRAMMING METHOD
The precedence diagramming method (PDM) is a technique used for
constructing a schedule model in which activities are represented by nodes and
are graphically linked by one or more logical relationships to show the sequence
in which the activities are to be performed.
PDM includes four types of dependencies or logical relationships. A
predecessor activity is an activity that logically comes before a dependent
activity in a schedule. A successor activity is a dependent activity that logically
comes after another activity in a schedule. These relationships are defined below
and are illustrated in Figure 6-9:
Finish-to-start (FS). A logical relationship in which a successor
activity cannot start until a predecessor activity has finished. For
example, installing the operating system on a PC (successor) cannot
start until the PC hardware is assembled (predecessor).
Finish-to-finish (FF). A logical relationship in which a successor
activity cannot finish until a predecessor activity has finished. For
example, writing a document (predecessor) is required to finish before
editing the document (successor) can finish.
Start-to-start (SS). A logical relationship in which a successor activity
cannot start until a predecessor activity has started. For example, level
concrete (successor) cannot begin until pour foundation (predecessor)
begins.
Start-to-finish (SF). A logical relationship in which a successor
activity cannot finish until a predecessor activity has started. For
example, a new accounts payable system (successor) has to start
before the old accounts payable system can be shut down
(predecessor).
In PDM, FS is the most commonly used type of precedence relationship. The
SF relationship is very rarely used, but is included to present a complete list of
the PDM relationship types.
Two activities can have two logical relationships at the same time (for
example, SS and FF). Multiple relationships between the same activities are not
recommended, so a decision has to be made to select the relationship with the
highest impact. Closed loops are also not recommended in logical relationships.
6.3.2.2 DEPENDENCY DETERMINATION AND INTEGRATION
Dependencies may be characterized by the following attributes: mandatory or
discretionary, internal or external (as described below). Dependency has four
attributes, but two can be applicable at the same time in the following ways:
mandatory external dependencies, mandatory internal dependencies,
discretionary external dependencies, or discretionary internal dependencies.
Mandatory dependencies. Mandatory dependencies are those that are
legally or contractually required or inherent in the nature of the work.
Mandatory dependencies often involve physical limitations, such as on
a construction project, where it is impossible to erect the
superstructure until after the foundation has been built, or on an
electronics project, where a prototype has to be built before it can be
tested. Mandatory dependencies are sometimes referred to as hard
logic or hard dependencies. Technical dependencies may not be
mandatory. The project team determines which dependencies are
mandatory during the process of sequencing the activities. Mandatory
dependencies should not be confused with assigning schedule
constraints in the scheduling tool.
Discretionary dependencies. Discretionary dependencies are
sometimes referred to as preferred logic, preferential logic, or soft
logic. Discretionary dependencies are established based on knowledge
of best practices within a particular application area or some unusual
aspect of the project where a specific sequence is desired, even though
there may be other acceptable sequences. For example, generally
accepted best practices recommend that during construction, the
electrical work should start after finishing the plumbing work. This
order is not mandatory and both activities may occur at the same time
(in parallel), but performing the activities in sequential order reduces
the overall project risk. Discretionary dependencies should be fully
documented since they can create arbitrary total float values and can
limit later scheduling options. When fast tracking techniques are
employed, these discretionary dependencies should be reviewed and
considered for modification or removal. The project team determines
which dependencies are discretionary during the process of sequencing
the activities.
External dependencies. External dependencies involve a relationship
between project activities and non-project activities. These
dependencies are usually outside of the project team's control. For
example, the testing activity in a software project may be dependent on
the delivery of hardware from an external source, or governmental
environmental hearings may need to be held before site preparation
can begin on a construction project. The project management team
determines which dependencies are external during the process of
sequencing the activities.
Internal dependencies. Internal dependencies involve a precedence
relationship between project activities and are generally inside the
project team's control. For example, if the team cannot test a machine
until they assemble it, there is an internal mandatory dependency. The
project management team determines which dependencies are internal
during the process of sequencing the activities.
6.3.2.3 LEADS AND LAGS
A lead is the amount of time a successor activity can be advanced with respect
to a predecessor activity. For example, on a project to construct a new office
building, the landscaping could be scheduled to start 2 weeks prior to the
scheduled punch list completion. This would be shown as a finish-to-start with a
2-week lead as shown in Figure 6-10. Lead is often represented as a negative
value for lag in scheduling software.
A lag is the amount of time a successor activity will be delayed with respect to
a predecessor activity. For example, a technical writing team may begin editing
the draft of a large document 15 days after they begin writing it. This can be
shown as a start-to-start relationship with a 15-day lag as shown in Figure 6-10.
Lag can also be represented in project schedule network diagrams as shown in
Figure 6-11 in the relationship between activities H and I (as indicated by the
nomenclature SS+10 (start-to-start plus 10 days lag) even though the offset is not
shown relative to a timescale).
The project management team determines the dependencies that may require a
lead or a lag to accurately define the logical relationship. The use of leads and
lags should not replace schedule logic. Also, duration estimates do not include
any leads or lags. Activities and their related assumptions should be
documented.
6.3.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems
includes scheduling software that has the capability to help plan, organize, and
adjust the sequence of the activities; insert the logical relationships, lead and lag
values; and differentiate the different types of dependencies.
6.3.3 SEQUENCE ACTIVITIES: OUTPUTS
6.3.3.1 PROJECT SCHEDULE NETWORK DIAGRAMS
A project schedule network diagram is a graphical representation of the
logical relationships, also referred to as dependencies, among the project
schedule activities. Figure 6-11 illustrates a project schedule network diagram. A
project schedule network diagram is produced manually or by using project
management software. It can include full project details, or have one or more
summary activities. A summary narrative can accompany the diagram and
describe the basic approach used to sequence the activities. Any unusual activity
sequences within the network should be fully described within the narrative.
Activities that have multiple predecessor activities indicate a path
convergence. Activities that have multiple successor activities indicate a path
divergence. Activities with divergence and convergence are at greater risk as
they are affected by multiple activities or can affect multiple activities. Activity I
is called a path convergence, as it has more than one predecessor, while activity
K is called a path divergence, as it has more than one successor.
6.3.3.2 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity attributes
may describe a necessary sequence of events or defined predecessor or
successor relationships, as well as defined lead and lag and logical
relationships between the activities.
Activity list. Described in Section 6.2.3.1. The activity list may be
impacted by the change in relationships among the project activities
during the sequencing activities.
Assumption log. Described in Section 4.1.3.2. Assumptions and
constraints recorded in the assumption log may need to be updated
based on the sequencing, relationship determination, and leads and
lags, and may give rise to individual project risks that may impact the
project schedule.
Milestone list. Described in Section 6.2.3.3. The scheduled dates for
specific milestones may be impacted by changes in relationships
among the project activities during the sequencing activities.
6.4 ESTIMATE ACTIVITY DURATIONS
Estimate Activity Durations is the process of estimating the number of work
periods needed to complete individual activities with estimated resources. The
key benefit of this process is that it provides the amount of time each activity
will take to complete. This process is performed throughout the project. The
inputs, tools and techniques, and outputs of this process are depicted in Figure 6-
12. Figure 6-13 depicts the data flow diagram of the process.
Estimating activity durations uses information from the scope of work,
required resource types or skill levels, estimated resource quantities, and
resource calendars. Other factors that may influence the duration estimates
include constraints imposed on the duration, effort involved, or type of resources
(e.g., fixed duration, fixed effort or work, fixed number of resources), as well as
the schedule network analysis technique used. The inputs for the estimates of
duration originate from the person or group on the project team who is most
familiar with the nature of the work in the specific activity. The duration
estimate is progressively elaborated, and the process considers the quality and
availability of the input data. For example, as more detailed and precise data are
available about the project engineering and design work, the accuracy and
quality of the duration estimates improve.
The Estimate Activity Durations process requires an estimation of the amount
of work effort required to complete the activity and the amount of available
resources estimated to complete the activity. These estimates are used to
approximate the number of work periods (activity duration) needed to complete
the activity using the appropriate project and resource calendars. In many cases,
the number of resources that are expected to be available to accomplish an
activity, along with the skill proficiency of those resources, may determine the
activity's duration. A change to a driving resource allocated to the activity will
usually have an effect on the duration, but this is not a simple “straight-line” or
linear relationship. Sometimes, the intrinsic nature of the work (i.e., constraints
imposed on the duration, effort involved, or number of resources) will take a
predetermined amount of time to complete regardless of the resource allocation
(e.g., a 24-hour stress test). Other factors for consideration when estimating
duration include:
Law of diminishing returns. When one factor (e.g., resource) used to
determine the effort required to produce a unit of work is increased
while all other factors remain fixed, a point will eventually be reached
at which additions of that one factor start to yield progressively
smaller or diminishing increases in output.
Number of resources. Increasing the number of resources to twice the
original number of the resources does not always reduce the time by
half, as it may increase extra duration due to risk, and at some point
adding too many resources to the activity may increase duration due to
knowledge transfer, learning curve, additional coordination, and other
factors involved.
Advances in technology. This may also play an important role in
determining duration estimates. For example, an increase in the output
of a manufacturing plant may be achieved by procuring the latest
advances in technology, which may impact duration and resource
needs.
Motivation of staff. The project manager also needs to be aware of
Student Syndrome—or procrastination—when people start to apply
themselves only at the last possible moment before the deadline, and
Parkinson's Law where work expands to fill the time available for its
completion.
All data and assumptions that support duration estimating are documented for
each activity duration estimate.
6.4.1 ESTIMATE ACTIVITY DURATIONS: INPUTS
6.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan defines the method used, as well as the
level of accuracy and other criteria required to estimate activity
durations.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
includes the WBS dictionary, which contains technical details that can
influence the effort and duration estimates.
6.4.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity attributes
may describe defined predecessor or successor relationships, as well as
defined lead and lag and logical relationships between the activities
that may impact duration estimates.
Activity list. Described in Section 6.2.3.1. The activity list contains all
schedule activities required on the project, which are to be estimated.
Dependencies and other constraints for these activities can influence
the duration estimates.
Assumption log. Described in Section 4.1.3.2. Assumptions and
constraints recorded in the assumption log may give rise to individual
project risks that may impact the project schedule.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to effort and duration estimating can
be applied to later phases in the project to improve the accuracy and
precision of effort and duration estimates.
Milestone list. Described in Section 6.2.3.3. The milestone list may
have scheduled dates for specific milestones that may impact the
duration estimates.
Project team assignments. Described in Section 9.3.3.1. The project is
staffed when the appropriate people have been assigned to the team.
Resource breakdown structure. Described in Section 9.2.3.3. The
resource breakdown structure provides a hierarchical structure of the
identified resources by resource category and resource type.
Resource calendars. Described in Section 9.2.1.2. The resource
calendars influence the duration of schedule activities due to the
availability of specific resources, type of resources, and resources with
specific attributes. Resource calendars specify when and how long
identified project resources will be available during the project.
Resource requirements. Described in Section 9.2.3.1. The estimated
activity resource requirements will have an effect on the duration of
the activity, since the level to which the resources assigned to the
activity meet the requirements will significantly influence the duration
of most activities. For example, if additional or lower-skilled resources
are assigned to an activity, there may be reduced efficiency or
productivity due to increased communication, training, and
coordination needs leading to a longer duration estimate.
Risk register. Described in Section 11.2.3.1. Individual project risks
may impact resource selection and availability. Updates to the risk
register are included with project documents updates, described in
Section 11.5.3.2, from Plan Risk Responses.
6.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Estimate Activity
Durations process include but are not limited to:
Duration estimating databases and other reference data,
Productivity metrics,
Published commercial information, and
Location of team members.
6.4.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Estimate Activity
Durations process include but are not limited to:
Historical duration information,
Project calendars,
Estimating policies,
Scheduling methodology, and
Lessons learned repository.
6.4.2 ESTIMATE ACTIVITY DURATIONS: TOOLS AND
TECHNIQUES
6.4.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Schedule development, management, and control;
Expertise in estimating; and
Discipline or application knowledge.
6.4.2.2 ANALOGOUS ESTIMATING
Analogous estimating is a technique for estimating the duration or cost of an
activity or a project using historical data from a similar activity or project.
Analogous estimating uses parameters from a previous, similar project, such as
duration, budget, size, weight, and complexity, as the basis for estimating the
same parameter or measure for a future project. When estimating durations, this
technique relies on the actual duration of previous, similar projects as the basis
for estimating the duration of the current project. It is a gross value estimating
approach, sometimes adjusted for known differences in project complexity.
Analogous duration estimating is frequently used to estimate project duration
when there is a limited amount of detailed information about the project.
Analogous estimating is generally less costly and less time-consuming than
other techniques, but it is also less accurate. Analogous duration estimates can be
applied to a total project or to segments of a project and may be used in
conjunction with other estimating methods. Analogous estimating is most
reliable when the previous activities are similar in fact and not just in
appearance, and the project team members preparing the estimates have the
needed expertise.
6.4.2.3 PARAMETRIC ESTIMATING
Parametric estimating is an estimating technique in which an algorithm is used
to calculate cost or duration based on historical data and project parameters.
Parametric estimating uses a statistical relationship between historical data and
other variables (e.g., square footage in construction) to calculate an estimate for
activity parameters, such as cost, budget, and duration.
Durations can be quantitatively determined by multiplying the quantity of
work to be performed by the number of labor hours per unit of work. For
example, duration on a design project is estimated by the number of drawings
multiplied by the number of labor hours per drawing, or on a cable installation,
the meters of cable multiplied by the number of labor hours per meter. If the
assigned resource is capable of installing 25 meters of cable per hour, the
duration required to install 1,000 meters is 40 hours (1,000 meters divided by 25
meters per hour).
This technique can produce higher levels of accuracy depending on the
sophistication and underlying data built into the model. Parametric schedule
estimates can be applied to a total project or to segments of a project, in
conjunction with other estimating methods.
6.4.2.4 THREE-POINT ESTIMATING
The accuracy of single-point duration estimates may be improved by
considering estimation uncertainty and risk. Using three-point estimates helps
define an approximate range for an activity's duration:
Most likely (tM). This estimate is based on the duration of the activity,
given the resources likely to be assigned, their productivity, realistic
expectations of availability for the activity, dependencies on other
participants, and interruptions.
Optimistic (tO). The activity duration based on analysis of the best-
case scenario for the activity.
Pessimistic (tP). The duration based on analysis of the worst-case
scenario for the activity.
Depending on the assumed distribution of values within the range of the three
estimates, the expected duration, tE, can be calculated. One commonly used
formula is triangular distribution:
tE = (tO + tM + tP) / 3.
Triangular distribution is used when there is insufficient historical data or
when using judgmental data. Duration estimates based on three points with an
assumed distribution provide an expected duration and clarify the range of
uncertainty around the expected duration.
6.4.2.5 BOTTOM-UP ESTIMATING
Bottom-up estimating is a method of estimating project duration or cost by
aggregating the estimates of the lower-level components of the WBS. When an
activity's duration cannot be estimated with a reasonable degree of confidence,
the work within the activity is decomposed into more detail. The detail durations
are estimated. These estimates are then aggregated into a total quantity for each
of the activity's durations. Activities may or may not have dependencies between
them that can affect the application and use of resources. If there are
dependencies, this pattern of resource usage is reflected and documented in the
estimated requirements of the activity.
6.4.2.6 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Alternatives analysis. Alternatives analysis is used to compare various
levels of resource capability or skills; scheduling compression
techniques (described in Section 6.5.2.6); different tools (manual
versus automated); and make, rent, or buy decisions regarding the
resources. This allows the team to weigh resource, cost, and duration
variables to determine an optimal approach for accomplishing project
work.
Reserve analysis. Reserve analysis is used to determine the amount of
contingency and management reserve needed for the project. Duration
estimates may include contingency reserves, sometimes referred to as
schedule reserves, to account for schedule uncertainty. Contingency
reserves are the estimated duration within the schedule baseline, which
is allocated for identified risks that are accepted. Contingency reserves
are associated with the known-unknowns, which may be estimated to
account for this unknown amount of rework. The contingency reserve
may be a percentage of the estimated activity duration or a fixed
number of work periods. Contingency reserves may be separated from
the individual activities and aggregated. As more precise information
about the project becomes available, the contingency reserve may be
used, reduced, or eliminated. Contingency should be clearly identified
in the schedule documentation.
Estimates may also be produced for the amount of management reserve of
schedule for the project. Management reserves are a specified amount of the
project budget withheld for management control purposes and are reserved
for unforeseen work that is within scope of the project. Management
reserves are intended to address the unknown-unknowns that can affect a
project. Management reserve is not included in the schedule baseline, but it
is part of the overall project duration requirements. Depending on contract
terms, use of management reserves may require a change to the schedule
baseline.
6.4.2.7 DECISION MAKING
Described in Section 5.2.2.4. Decision-making techniques that can be used in
this process include but are not limited to voting. One variation of the voting
method that is often used in agile-based projects is called the fist of five (also
called fist to five). In this technique, the project manager asks the team to show
their level of support for a decision by holding up a closed fist (indicating no
support) up to five fingers (indicating full support). If a team member holds up
fewer than three fingers, the team member is given the opportunity to discuss
any objections with the team. The project manager continues the fist-of-five
process until the team achieves consensus (everyone holds up three or more
fingers) or agrees to move on to the next decision.
6.4.2.8 MEETINGS
The project team may hold meetings to estimate activity durations. When
using an agile approach, it is necessary to conduct sprint or iteration planning
meetings to discuss prioritized product backlog items (user stories) and decide
which of these items the team will commit to work on in the upcoming iteration.
The team breaks down user stories to low-level tasks, with estimates in hours,
and then validates that the estimates are achievable based on team capacity over
the duration (iteration). This meeting is usually held on the first day of the
iteration and is attended by the product owner, the Scrum team, and the project
manager. The outcome of the meeting includes an iteration backlog, as well as
assumptions, concerns, risks, dependencies, decisions, and actions.
6.4.3 ESTIMATE ACTIVITY DURATIONS: OUTPUTS
6.4.3.1 DURATION ESTIMATES
Duration estimates are quantitative assessments of the likely number of time
periods that are required to complete an activity, a phase, or a project. Duration
estimates do not include any lags as described in Section 6.3.2.3. Duration
estimates may include some indication of the range of possible results. For
example:
A range of 2 weeks ± 2 days, which indicates that the activity will take
at least 8 days and not more than 12 (assuming a 5-day work week); or
A 15% probability of exceeding 3 weeks, which indicates a high
probability—85%—that the activity will take 3 weeks or less.
6.4.3.2 BASIS OF ESTIMATES
The amount and type of additional details supporting the duration estimate
vary by application area. Regardless of the level of detail, the supporting
documentation should provide a clear and complete understanding of how the
duration estimate was derived.
Supporting detail for duration estimates may include:
Documentation of the basis of the estimate (i.e., how it was
developed),
Documentation of all assumptions made,
Documentation of any known constraints,
Indication of the range of possible estimates (e.g., ±10%) to indicate
that the duration is estimated between a range of values),
Indication of the confidence level of the final estimate, and
Documentation of individual project risks influencing this estimate.
6.4.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity duration
estimates produced during this process are documented as part of the
activity attributes.
Assumption log. Described in Section 4.1.3.2. This includes
assumptions made in developing the duration estimate, such as
resource skill levels and availability, as well as a basis of estimates for
durations. Additionally, constraints arising out of the scheduling
methodology and scheduling tool are also documented.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were efficient and
effective in developing effort and duration estimates.
6.5 DEVELOP SCHEDULE
Develop Schedule is the process of analyzing activity sequences, durations,
resource requirements, and schedule constraints to create a schedule model for
project execution and monitoring and controlling. The key benefit of this process
is that it generates a schedule model with planned dates for completing project
activities. This process is performed throughout the project. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 6-14. Figure 6-15
depicts the data flow diagram of the process.
Developing an acceptable project schedule is an iterative process. The
schedule model is used to determine the planned start and finish dates for project
activities and milestones based on the best available information. Schedule
development can require the review and revision of duration estimates, resource
estimates, and schedule reserves to establish an approved project schedule that
can serve as a baseline to track progress. Key steps include defining the project
milestones, identifying and sequencing activities, and estimating durations. Once
the activity start and finish dates have been determined, it is common to have the
project staff assigned to the activities review their assigned activities. The staff
confirms that the start and finish dates present no conflict with resource
calendars or assigned activities on other projects or tasks and thus are still valid.
The schedule is then analyzed to determine conflicts with logical relationships
and if resource leveling is required before the schedule is approved and
baselined. Revising and maintaining the project schedule model to sustain a
realistic schedule continues throughout the duration of the project, as described
in Section 6.7.
For more specific information regarding scheduling, refer to the Practice
Standard for Scheduling.
6.5.1 DEVELOP SCHEDULE: INPUTS
6.5.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan identifies the scheduling method and tool
used to create the schedule and how the schedule is to be calculated.
Scope baseline. Described in Section 5.4.3.1. The scope statement,
WBS, and WBS dictionary have details about the project deliverables
that are considered when building the schedule model.
6.5.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Activity attributes. Described in Section 6.2.3.2. The activity attributes
provide the details used to build the schedule model.
Activity list. Described in Section 6.2.3.1. The activity list identifies
the activities that will be included in the schedule model.
Assumption log. Described in Section 4.1.3.2. Assumptions and
constraints recorded in the assumption log may give rise to individual
project risks that may impact the project schedule.
Basis of estimates. Described in Section 6.4.3.2. The amount and type
of additional details supporting the duration estimate vary by
application area. Regardless of the level of detail, the supporting
documentation should provide a clear and complete understanding of
how the duration estimate was derived.
Duration estimates. Described in Section 6.4.3.1. The duration
estimates contain the quantitative assessments of the likely number of
work periods that will be required to complete an activity. This will be
used to calculate the schedule.
Lessons learned. Described in Section 4.4.3.1. Lessons learned earlier
in the project with regard to developing the schedule model can be
applied to later phases in the project to improve the validity of the
schedule model.
Milestone list. Described in Section 6.2.3.3. The milestone list has
scheduled dates for specific milestones.
Project schedule network diagrams. Described in Section 6.3.3.1. The
project schedule network diagrams contain the logical relationships of
predecessors and successors that will be used to calculate the schedule.
Project team assignments. Described in Section 9.3.3.1. The project
team assignments specify which resources are assigned to each
activity.
Resource calendars. Described in Sections 9.2.1.2. The resource
calendars contain information on the availability of resources during
the project.
Resource requirements. Described in Section 9.2.3.1. The activity
resource requirements identify the types and quantities of resources
required for each activity used to create the schedule model.
Risk register. Described in Section 11.2.3.1. The risk register provides
the details of all identified risks, and their characteristics, that affect
the schedule model. Risk information relevant to the schedule is
reflected in schedule reserves using the expected or mean risk impact.
6.5.1.3 AGREEMENTS
Described in Section 12.2.3.2. Vendors may have an input to the project
schedule as they develop the details of how they will perform the project work to
meet contractual commitments.
6.5.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Develop Schedule
process include but are not limited to:
Government or industry standards, and
Communication channels.
6.5.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Develop Schedule
process include but are not limited to:
Scheduling methodology containing the policies governing schedule
model development and maintenance, and
Project calendar(s).
6.5.2 DEVELOP SCHEDULE: TOOLS AND TECHNIQUES
6.5.2.1 SCHEDULE NETWORK ANALYSIS
Schedule network analysis is the overarching technique used to generate the
project schedule model. It employs several other techniques such as critical path
method (described in Section 6.5.2.2), resource optimization techniques
(described in Section 6.5.2.3), and modeling techniques (described in Section
6.5.2.4). Additional analysis includes but is not limited to:
Assessing the need to aggregate schedule reserves to reduce the
probability of a schedule slip when multiple paths converge at a single
point in time or when multiple paths diverge from a single point in
time, to reduce the probability of a schedule slip.
Reviewing the network to see if the critical path has high-risk
activities or long lead items that would necessitate use of schedule
reserves or the implementation of risk responses to reduce the risk on
the critical path.
Schedule network analysis is an iterative process that is employed until a
viable schedule model is developed.
6.5.2.2 CRITICAL PATH METHOD
The critical path method is used to estimate the minimum project duration and
determine the amount of schedule flexibility on the logical network paths within
the schedule model. This schedule network analysis technique calculates the
early start, early finish, late start, and late finish dates for all activities without
regard for any resource limitations by performing a forward and backward pass
analysis through the schedule network, as shown in Figure 6-16. In this example,
the longest path includes activities A, C, and D, and therefore the sequence of A-
C-D is the critical path. The critical path is the sequence of activities that
represents the longest path through a project, which determines the shortest
possible project duration. The longest path has the least total float—usually zero.
The resulting early and late start and finish dates are not necessarily the project
schedule; rather they indicate the time periods within which the activity could be
executed, using the parameters entered in the schedule model for activity
durations, logical relationships, leads, lags, and other known constraints. The
critical path method is used to calculate the critical path(s) and the amount of
total and free float or schedule flexibility on the logical network paths within the
schedule model.
On any network path, the total float or schedule flexibility is measured by the
amount of time that a schedule activity can be delayed or extended from its early
start date without delaying the project finish date or violating a schedule
constraint. A critical path is normally characterized by zero total float on the
critical path. As implemented with the precedence diagramming method
sequencing, critical paths may have positive, zero, or negative total float
depending on the constraints applied. Positive total float is caused when the
backward pass is calculated from a schedule constraint that is later than the early
finish date that has been calculated during forward pass calculation. Negative
total float is caused when a constraint on the late dates is violated by duration
and logic. Negative float analysis is a technique that helps to find possible
accelerated ways of bringing a delayed schedule back on track. Schedule
networks may have multiple near-critical paths. Many software packages allow
the user to define the parameters used to determine the critical path(s).
Adjustments to activity durations (when more resources or less scope can be
arranged), logical relationships (when the relationships were discretionary to
begin with), leads and lags, or other schedule constraints may be necessary to
produce network paths with a zero or positive total float. Once the total float and
the free float have been calculated, the free float is the amount of time that a
schedule activity can be delayed without delaying the early start date of any
successor or violating a schedule constraint. For example the free float for
Activity B, in Figure 6-16, is 5 days.
6.5.2.3 RESOURCE OPTIMIZATION
Resource optimization is used to adjust the start and finish dates of activities
to adjust planned resource use to be equal to or less than resource availability.
Examples of resource optimization techniques that can be used to adjust the
schedule model due to demand and supply of resources include but are not
limited to:
Resource leveling. A technique in which start and finish dates are
adjusted based on resource constraints with the goal of balancing the
demand for resources with the available supply. Resource leveling can
be used when shared or critically required resources are available only
at certain times or in limited quantities, or are over-allocated, such as
when a resource has been assigned to two or more activities during the
same time period (as shown in Figure 6-17), or there is a need to keep
resource usage at a constant level. Resource leveling can often cause
the original critical path to change. Available float is used for leveling
resources. Consequently, the critical path through the project schedule
may change.
Resource smoothing. A technique that adjusts the activities of a
schedule model such that the requirements for resources on the project
do not exceed certain predefined resource limits. In resource
smoothing, as opposed to resource leveling, the project's critical path is
not changed and the completion date may not be delayed. In other
words, activities may only be delayed within their free and total float.
Resource smoothing may not be able to optimize all resources.
6.5.2.4 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
What-if scenario analysis. What-if scenario analysis is the process of
evaluating scenarios in order to predict their effect, positive or
negative, on project objectives. This is an analysis of the question,
“What if the situation represented by scenario X happens?” A schedule
network analysis is performed using the schedule to compute the
different scenarios, such as delaying a major component delivery,
extending specific engineering durations, or introducing external
factors, such as a strike or a change in the permit process. The
outcome of the what-if scenario analysis can be used to assess the
feasibility of the project schedule under different conditions, and in
preparing schedule reserves and response plans to address the impact
of unexpected situations.
Simulation. Simulation models the combined effects of individual
project risks and other sources of uncertainty to evaluate their potential
impact on achieving project objectives. The most common simulation
technique is Monte Carlo analysis (see Section 11.4.2.5), in which
risks and other sources of uncertainty are used to calculate possible
schedule outcomes for the total project. Simulation involves
calculating multiple work package durations with different sets of
activity assumptions, constraints, risks, issues, or scenarios using
probability distributions and other representations of uncertainty (see
Section 11.4.2.4). Figure 6-18 shows a probability distribution for a
project with the probability of achieving a certain target date (i.e.,
project finish date). In this example, there is a 10% probability that the
project will finish on or before the target date of May 13, while there is
a 90% probability of completing the project by May 28.
For more information on how Monte Carlo simulation is used for schedule
models, see the Practice Standard for Scheduling.
6.5.2.5 LEADS AND LAGS
Described in Section 6.3.2.3. Leads and lags are refinements applied during
network analysis to develop a viable schedule by adjusting the start time of the
successor activities. Leads are used in limited circumstances to advance a
successor activity with respect to the predecessor activity, and lags are used in
limited circumstances where processes require a set period of time to elapse
between the predecessors and successors without work or resource impact.
6.5.2.6 SCHEDULE COMPRESSION
Schedule compression techniques are used to shorten or accelerate the
schedule duration without reducing the project scope in order to meet schedule
constraints, imposed dates, or other schedule objectives. A helpful technique is
the negative float analysis. The critical path is the one with the least float. Due to
violating a constraint or imposed date, the total float can become negative.
Schedule compression techniques are compared in Figure 6-19 and include:
Crashing. A technique used to shorten the schedule duration for the
least incremental cost by adding resources. Examples of crashing
include approving overtime, bringing in additional resources, or
paying to expedite delivery to activities on the critical path. Crashing
works only for activities on the critical path where additional resources
will shorten the activity's duration. Crashing does not always produce
a viable alternative and may result in increased risk and/or cost.
Fast tracking. A schedule compression technique in which activities or
phases normally done in sequence are performed in parallel for at least
a portion of their duration. An example is constructing the foundation
for a building before completing all of the architectural drawings. Fast
tracking may result in rework and increased risk. Fast tracking only
works when activities can be overlapped to shorten the project
duration on the critical path. Using leads in case of schedule
acceleration usually increases coordination efforts between the
activities concerned and increases quality risk. Fast tracking may also
increase project costs.
6.5.2.7 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems
include scheduling software that expedites the process of building a schedule
model by generating start and finish dates based on the inputs of activities,
network diagrams, resources, and activity durations.
6.5.2.8 AGILE RELEASE PLANNING
Agile release planning provides a high-level summary timeline of the release
schedule (typically 3 to 6 months) based on the product roadmap and the product
vision for the product's evolution. Agile release planning also determines the
number of iterations or sprints in the release, and allows the product owner and
team to decide how much needs to be developed and how long it will take to
have a releasable product based on business goals, dependencies, and
impediments.
Since features represent value to the customer, the timeline provides a more
easily understood project schedule as it defines which feature will be available at
the end of each iteration, which is exactly the depth of information the customer
is looking for.
Figure 6-20 shows the relationship among product vision, product roadmap,
release planning, and iteration planning.
6.5.3 DEVELOP SCHEDULE: OUTPUTS
6.5.3.1 SCHEDULE BASELINE
A schedule baseline is the approved version of a schedule model that can be
changed only through formal change control procedures and is used as a basis
for comparison to actual results. It is accepted and approved by the appropriate
stakeholders as the schedule baseline with baseline start dates and baseline finish
dates. During monitoring and controlling, the approved baseline dates are
compared to the actual start and finish dates to determine if variances have
occurred. The schedule baseline is a component of the project management plan.
6.5.3.2 PROJECT SCHEDULE
The project schedule is an output of a schedule model that presents linked
activities with planned dates, durations, milestones, and resources. At a
minimum, the project schedule includes a planned start date and planned finish
date for each activity. If resource planning is done at an early stage, the project
schedule remains preliminary until resource assignments have been confirmed
and scheduled start and finish dates are established. This process usually occurs
no later than the completion of the project management plan (Section 4.2.3.1). A
target project schedule model may also be developed with a defined target start
and target finish for each activity. The project schedule may be presented in
summary form, sometimes referred to as the master schedule or milestone
schedule, or presented in detail. Although a project schedule model can be
presented in tabular form, it is more often presented graphically, using one or
more of the following formats:
Bar charts. Also known as Gantt charts, bar charts represent schedule
information where activities are listed on the vertical axis, dates are
shown on the horizontal axis, and activity durations are shown as
horizontal bars placed according to start and finish dates. Bar charts
are relatively easy to read and are commonly used. Depending on the
audience, float can be depicted or not. For control and management
communications, the broader, more comprehensive summary activity
is used between milestones or across multiple interdependent work
packages and is displayed in bar chart reports. An example is the
summary schedule portion of Figure 6-21 that is presented in a WBS-
structured format.
Milestone charts. These charts are similar to bar charts, but only
identify the scheduled start or completion of major deliverables and
key external interfaces. An example is the milestone schedule portion
of Figure 6-21.
Project schedule network diagrams. These diagrams are commonly
presented in the activity-on-node diagram format showing activities
and relationships without a time scale, sometimes referred to as a pure
logic diagram, as shown in Figure 6-11, or presented in a time-scaled
schedule network diagram format that is sometimes called a logic bar
chart, as shown for the detailed schedule in Figure 6-21. These
diagrams, with activity date information, usually show both the project
network logic and the project's critical path schedule activities. This
example also shows how each work package is planned as a series of
related activities. Another presentation of the project schedule network
diagram is a time-scaled logic diagram. These diagrams include a time
scale and bars that represent the duration of activities with the logical
relationships. They are optimized to show the relationships between
activities where any number of activities may appear on the same line
of the diagram in sequence.
Figure 6-21 shows schedule presentations for a sample project being executed,
with the work in progress reported through as-of date or status date. For a simple
project schedule model, Figure 6-21 reflects schedule presentations in the forms
of (1) a milestone schedule as a milestone chart, (2) a summary schedule as a bar
chart, and (3) a detailed schedule as a project schedule linked bar chart diagram.
Figure 6-21 also visually shows the relationships among the different levels of
detail of the project schedule.
6.5.3.3 SCHEDULE DATA
The schedule data for the project schedule model is the collection of
information for describing and controlling the schedule. The schedule data
includes, at a minimum, the schedule milestones, schedule activities, activity
attributes, and documentation of all identified assumptions and constraints. The
amount of additional data varies by application area. Information frequently
supplied as supporting detail includes but is not limited to:
Resource requirements by time period, often in the form of a resource
histogram;
Alternative schedules, such as best-case or worst-case, not resource-
leveled or resource-leveled, or with or without imposed dates; and
Applied schedule reserves.
Schedule data could also include such items as resource histograms, cash-flow
projections, order and delivery schedules, or other relevant information.
6.5.3.4 PROJECT CALENDARS
A project calendar identifies working days and shifts that are available for
scheduled activities. It distinguishes time periods in days or parts of days that are
available to complete scheduled activities from time periods that are not
available for work. A schedule model may require more than one project
calendar to allow for different work periods for some activities to calculate the
project schedule. The project calendars may be updated.
6.5.3.5 CHANGE REQUESTS
Described in Section 4.3.3.4. Modifications to the project scope or project
schedule may result in change requests to the scope baseline, and/or other
components of the project management plan. Change requests are processed for
review and disposition through the Perform Integrated Change Control process
(Section 4.6). Preventive actions may include recommended changes to
eliminate or reduce the probability of negative schedule variances.
6.5.3.6 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan may be updated to reflect a change in the
way the schedule was developed and will be managed.
Cost baseline. Described in Section 7.3.3.1. Changes to the cost
baseline are incorporated in response to approved changes in scope,
resources, or cost estimates. In some cases, cost variances can be so
severe that a revised cost baseline is needed to provide a realistic basis
for performance measurement.
6.5.3.7 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity attributes are
updated to include any revised resource requirements and any other
revisions generated by the Develop Schedule process.
Assumption log. Described in Section 4.1.3.2. The assumption log
may be updated with changes to assumptions in duration, resource
utilization, sequencing, or other information that is revealed as a result
of developing the schedule model.
Duration estimates. Described in Section 6.4.3.1. The number and
availability of resources, along with the activity dependencies can
result in a change to the duration estimates. If the resource-leveling
analysis changes the resource requirements, then the duration
estimates will likely need to be updated as well.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were efficient and
effective in developing the schedule model.
Resource requirements. Described in Section 9.2.3.1. Resource
leveling can have a significant effect on preliminary estimates for the
types and quantities of resources required. If the resource-leveling
analysis changes the resource requirements, then the resource
requirements are updated.
Risk register. Described in Section 11.2.3.1. The risk register may
need to be updated to reflect opportunities or threats perceived through
scheduling assumptions.
6.6 CONTROL SCHEDULE
Control Schedule is the process of monitoring the status of the project to
update the project schedule and managing changes to the schedule baseline. The
key benefit of this process is that the schedule baseline is maintained throughout
the project. This process is performed throughout the project. The inputs, tools
and techniques, and outputs of this process are depicted in Figure 6-22. Figure 6-
23 depicts the data flow diagram of the process.
Updating the schedule model requires knowing the actual performance to
date. Any change to the schedule baseline can only be approved through the
Perform Integrated Change Control process (Section 4.6). Control Schedule, as a
component of the Perform Integrated Change Control process, is concerned
with:
Determining the current status of the project schedule,
Influencing the factors that create schedule changes,
Reconsidering necessary schedule reserves,
Determining if the project schedule has changed, and
Managing the actual changes as they occur.
When an agile approach is used, Control Schedule is concerned with:
Determining the current status of the project schedule by comparing
the total amount of work delivered and accepted against the estimates
of work completed for the elapsed time cycle;
Conducting retrospectives (scheduled reviews to record lessons
learned) for correcting processes and improving, if required;
Reprioritizing the remaining work plan (backlog);
Determining the rate at which the deliverables are produced, validated,
and accepted (velocity) in the given time per iteration (agreed-upon
work cycle duration, typically 2 weeks or 1 month);
Determining that the project schedule has changed; and
Managing the actual changes as they occur.
When work is being contracted, regular and milestone status updates from
contractors and suppliers are a means of ensuring the work is progressing as
agreed upon to ensure the schedule is under control. Scheduled status reviews
and walkthroughs should be done to ensure the contractor reports are accurate
and complete.
6.6.1 CONTROL SCHEDULE: INPUTS
6.6.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management describes the frequency that the schedule will
be updated, how reserve will be used, and how the schedule will be
controlled.
Schedule baseline. Described in Section 6.5.3.1. The schedule baseline
is compared with actual results to determine if a change, corrective
action, or preventive action is necessary.
Scope baseline. Described in Section 5.4.3.1. The project WBS,
deliverables, constraints, and assumptions documented in the scope
baseline are considered explicitly when monitoring and controlling the
schedule baseline.
Performance measurement baseline. Described in Section 4.2.3.1.
When using earned value analysis the performance measurement
baseline is compared to actual results to determine if a change,
corrective action, or preventive action is necessary.
6.6.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve schedule control.
Project calendars. Described in Section 6.5.3.4. A schedule model may
require more than one project calendar to allow for different work
periods for some activities to calculate the schedule forecasts.
Project schedule. Described in Section 6.5.3.2. Project schedule refers
to the most recent version with notations to indicate updates,
completed activities, and started activities as of the indicated date.
Resource calendars. Described in Section 9.2.1.2. Resource calendars
show the availability of team and physical resources.
Schedule data. Described in Section 6.5.3.3. Schedule data will be
reviewed and updated in the Control Schedule process.
6.6.1.3 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on project
status such as which activities have started, their progress (e.g., actual duration,
remaining duration, and physical percent complete), and which activities have
finished.
6.6.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Schedule
process include but are not limited to:
Existing formal and informal schedule control-related policies,
procedures, and guidelines;
Schedule control tools; and
Monitoring and reporting methods to be used.
6.6.2 CONTROL SCHEDULE: TOOLS AND TECHNIQUES
6.6.2.1 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Earned value analysis. Described in Section 7.4.2.2. Schedule
performance measurements such as schedule variance (SV) and
schedule performance index (SPI) are used to assess the magnitude of
variation to the original schedule baseline.
Iteration burndown chart. This chart tracks the work that remains to be
completed in the iteration backlog. It is used to analyze the variance
with respect to an ideal burndown based on the work committed from
iteration planning (see Section 6.4.2.8). A forecast trend line can be
used to predict the likely variance at iteration completion and take
appropriate actions during the course of the iteration. A diagonal line
representing the ideal burndown and daily actual remaining work is
then plotted. A trend line is then calculated to forecast completion
based on remaining work. Figure 6-24 is an example of an iteration
burndown chart.
Performance reviews. Performance reviews measure, compare, and
analyze schedule performance against the schedule baseline such as
actual start and finish dates, percent complete, and remaining duration
for work in progress.
Trend analysis. Described in Section 4.5.2.2. Trend analysis examines
project performance over time to determine whether performance is
improving or deteriorating. Graphical analysis techniques are valuable
for understanding performance to date and for comparing to future
performance goals in the form of completion dates.
Variance analysis. Variance analysis looks at variances in planned
versus actual start and finish dates, planned versus actual durations,
and variances in float. Part of variance analysis is determining the
cause and degree of variance relative to the schedule baseline (see
Section 6.5.3.1), estimating the implications of those variances for
future work to completion, and deciding whether corrective or
preventive action is required. For example, a major delay on any
activity not on the critical path may have little effect on the overall
project schedule, while a much shorter delay on a critical or near-
critical activity may require immediate action.
What-if scenario analysis. Described in Section 6.5.2.4. What-if
scenario analysis is used to assess the various scenarios guided by the
output from the Project Risk Management processes to bring the
schedule model into alignment with the project management plan and
approved baseline.
6.6.2.2 CRITICAL PATH METHOD
Described in Section 6.5.2.2. Comparing the progress along the critical path
can help determine schedule status. The variance on the critical path will have a
direct impact on the project end date. Evaluating the progress of activities on
near critical paths can identify schedule risk.
6.6.2.3 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems
include scheduling software that provides the ability to track planned dates
versus actual dates, to report variances to and progress made against the
schedule baseline, and to forecast the effects of changes to the project schedule
model.
6.6.2.4 RESOURCE OPTIMIZATION
Described in Section 6.5.2.3. Resource optimization techniques involve the
scheduling of activities and the resources required by those activities while
taking into consideration both the resource availability and the project time.
6.6.2.5 LEADS AND LAGS
Adjusting leads and lags is applied during network analysis to find ways to
bring project activities that are behind into alignment with the plan. For example,
on a project to construct a new office building, the landscaping can be adjusted
to start before the exterior work of the building is completed by increasing the
lead time in the relationship, or a technical writing team can adjust the start of
editing the draft of a large document immediately after the document is written
by eliminating or decreasing lag time.
6.6.2.6 SCHEDULE COMPRESSION
Schedule compression techniques (see Section 6.5.2.6) are used to find ways
to bring project activities that are behind into alignment with the plan by fast
tracking or crashing the schedule for the remaining work.
6.6.3 CONTROL SCHEDULE: OUTPUTS
6.6.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how the project work is performing compared to the schedule
baseline. Variances in the start and finish dates and the durations can be
calculated at the work package level and control account level. For projects
using earned value analysis, the (SV) and (SPI) are documented for inclusion in
work performance reports (see Section 4.5.3.1).
6.6.3.2 SCHEDULE FORECASTS
Schedule updates are forecasts of estimates or predictions of conditions and
events in the project's future based on information and knowledge available at
the time of the forecast. Forecasts are updated and reissued based on work
performance information provided as the project is executed. The information is
based on the project's past performance and expected future performance based
on corrective or preventive actions. This can include earned value performance
indicators, as well as schedule reserve information that could impact the project
in the future.
6.6.3.3 CHANGE REQUESTS
Described in Section 4.3.3.4. Schedule variance analysis, as well as reviews of
progress reports, results of performance measures, and modifications to the
project scope or project schedule, may result in change requests to the schedule
baseline, scope baseline, and/or other components of the project management
plan. Change requests are processed for review and disposition through the
Perform Integrated Change Control process (Section 4.6). Preventive actions
may include recommended changes to eliminate or reduce the probability of
negative schedule variances.
6.6.3.4 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan may be updated to reflect a change in the
way the schedule is managed.
Schedule baseline. Described in Section 6.5.3.1. Changes to the
schedule baseline are incorporated in response to approved change
requests related to change in project scope, resources, or activity
duration estimates. The schedule baseline may be updated to reflect
changes caused by schedule compression techniques or performance
issues.
Cost baseline. Described in Section 7.3.3.1. Changes to the cost
baseline are incorporated in response to approved changes in scope,
resources, or cost estimates.
Performance measurement baseline. Described in Section 4.2.3.1.
Changes to the performance measurement baseline are incorporated in
response to approved changes in scope, schedule performance, or cost
estimates. In some cases, the performance variances can be so severe
that a change request is put forth to revise the performance
measurement baseline to provide a realistic basis for performance
measurement.
6.6.3.5 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. Schedule performance
may indicate the need to revise assumptions on activity sequencing,
durations, and productivity.
Basis of estimates. Described in Section 6.4.3.2. Schedule
performance may indicate the need to revise the way duration
estimates were developed.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were effective in
maintaining the schedule, causes of variances, and corrective actions
that were used to respond to schedule variances.
Project schedule. An updated project schedule (see Section 6.5.3.2)
will be generated from the schedule model populated with updated
schedule data to reflect the schedule changes and manage the project.
Resource calendars. Described in Section 9.2.1.2. Resource calendars
are updated to reflect changes to the utilization of resource calendars
that were the result of optimizing resources, schedule compression,
and corrective or preventive actions.
Risk register. Described in Section 11.2.3.1. The risk register and risk
response plans within it, may be updated based on the risks that may
arise due to schedule compression techniques.
Schedule data. Described in Section 6.5.3.3. New project schedule
network diagrams may be developed to display approved remaining
durations and approved modifications to the schedule. In some cases,
project schedule delays can be so severe that a new target schedule
with forecasted start and finish dates is needed to provide realistic data
for directing the work, measuring performance, and measuring
progress.
7
PROJECT COST MANAGEMENT
Project Cost Management includes the processes involved in planning,
estimating, budgeting, financing, funding, managing, and controlling costs so
that the project can be completed within the approved budget. The Project Cost
Management processes are:
7.1 Plan Cost Management—The process of defining how the project costs
will be estimated, budgeted, managed, monitored, and controlled.
7.2 Estimate Costs—The process of developing an approximation of the
monetary resources needed to complete project work.
7.3 Determine Budget—The process of aggregating the estimated costs of
individual activities or work packages to establish an authorized cost baseline.
7.4 Control Costs—The process of monitoring the status of the project to
update the project costs and manage changes to the cost baseline.
Figure 7-1 provides an overview of the Project Cost Management processes.
The Project Cost Management processes are presented as discrete processes with
defined interfaces, while in practice they overlap and interact in ways that cannot
be completely detailed in the PMBOK® Guide. These processes interact with
each other and with processes in other Knowledge Areas.
On some projects, especially those of smaller scope, cost estimating and cost
budgeting are tightly linked and can be viewed as a single process that can be
performed by a single person over a relatively short period of time. They are
presented here as distinct processes because the tools and techniques for each are
different. The ability to influence cost is greatest at the early stages of the
project, making early scope definition critical (see Section 5.3).
KEY CONCEPTS FOR PROJECT COST MANAGEMENT
Project Cost Management is primarily concerned with the cost of the
resources needed to complete project activities. Project Cost Management should
consider the effect of project decisions on the subsequent recurring cost of using,
maintaining, and supporting the product, service, or result of the project. For
example, limiting the number of design reviews can reduce the cost of the
project but could increase the resulting product's operating costs.
Another aspect of cost management is recognizing that different stakeholders
measure project costs in different ways and at different times. For example, the
cost of an acquired item may be measured when the acquisition decision is made
or committed, the order is placed, the item is delivered, or the actual cost is
incurred or recorded for project accounting purposes. In many organizations,
predicting and analyzing the prospective financial performance of the project's
product is performed outside of the project. In others, such as a capital facilities
project, Project Cost Management can include this work. When such predictions
and analyses are included, Project Cost Management may address additional
processes and numerous general financial management techniques such as return
on investment, discounted cash flow, and investment payback analysis.
TRENDS AND EMERGING PRACTICES IN PROJECT COST
MANAGEMENT
Within the practice of Project Cost Management, trends include the expansion
of earned value management (EVM) to include the concept of earned schedule
(ES).
ES is an extension to the theory and practice of EVM. Earned schedule theory
replaces the schedule variance measures used in traditional EVM (earned value
− planned value) with ES and actual time (AT). Using the alternate equation for
calculating schedule variance ES − AT, if the amount of earned schedule is
greater than 0, then the project is considered ahead of schedule. In other words,
the project earned more than planned at a given point in time. The schedule
performance index (SPI) using earned schedule metrics is ES/AT. This indicates
the efficiency with which work is being accomplished. Earned schedule theory
also provides formulas for forecasting the project completion date, using earned
schedule, actual time, and estimated duration.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager may need to tailor the
way Project Cost Management processes are applied. Considerations for
tailoring include but are not limited to:
Knowledge management. Does the organization have a formal
knowledge management and financial database repository that a
project manager is required to use and that is readily accessible?
Estimating and budgeting. Does the organization have existing formal
or informal cost estimating and budgeting-related policies, procedures,
and guidelines?
Earned value management. Does the organization use earned value
management in managing projects?
Use of agile approach. Does the organization use agile methodologies
in managing projects? How does this impact cost estimating?
Governance. Does the organization have formal or informal audit and
governance policies, procedures, and guidelines?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Projects with high degrees of uncertainty or those where the scope is not yet
fully defined may not benefit from detailed cost calculations due to frequent
changes. Instead, lightweight estimation methods can be used to generate a fast,
high-level forecast of project labor costs, which can then be easily adjusted as
changes arise. Detailed estimates are reserved for short-term planning horizons
in a just-in-time fashion.
In cases where high-variability projects are also subject to strict budgets, the
scope and schedule are more often adjusted to stay within cost constraints.
7.1 PLAN COST MANAGEMENT
Plan Cost Management is the process of defining how the project costs will be
estimated, budgeted, managed, monitored, and controlled. The key benefit of
this process is that it provides guidance and direction on how the project costs
will be managed throughout the project. This process is performed once or at
predefined points in the project. The inputs, tools and techniques, and outputs of
this process are depicted in Figure 7-2. Figure 7-3 depicts the data flow diagram
of the process.
The cost management planning effort occurs early in project planning and sets
the framework for each of the cost management processes so that performance of
the processes will be efficient and coordinated. The cost management processes
and their associated tools and techniques are documented in the cost
management plan. The cost management plan is a component of the project
management plan.
7.1.1 PLAN COST MANAGEMENT: INPUTS
7.1.1.1 PROJECT CHARTER
Described in Section 4.2.3.1. The project charter provides the preapproved
financial resources from which the detailed project costs are developed. The
project charter also defines the project approval requirements that will influence
the management of the project costs.
7.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan establishes the criteria and the activities for
developing, monitoring, and controlling the schedule. The schedule
management plan provides processes and controls that will impact cost
estimation and management.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan provides the approach for identifying, analyzing,
and monitoring risks. The risk management plan provides processes
and controls that will impact cost estimation and management.
7.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Cost
Management process include but are not limited to:
Organizational culture and structure can influence cost management.
Market conditions describe what products, services, and results are
available in the regional and global markets.
Currency exchange rates for project costs are sourced from more than
one country.
Published commercial information such as resource cost rate
information is often available from commercial databases that track
skills and human resource costs, and provide standard costs for
material and equipment. Published seller price lists are another source
of information.
Project management information system provides alternative
possibilities for managing cost.
Productivity differences in different parts of the world can have a large
influence on the cost of projects.
7.1.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Cost
Management process include but are not limited to:
Financial controls procedures (e.g., time reporting, required
expenditure and disbursement reviews, accounting codes, and standard
contract provisions);
Historical information and lessons learned repository;
Financial databases; and
Existing formal and informal cost estimating and budgeting-related
policies, procedures, and guidelines.
7.1.2 PLAN COST MANAGEMENT: TOOLS AND TECHNIQUES
7.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Previous similar projects;
Information in the industry, discipline, and application area;
Cost estimating and budgeting; and
Earned value management.
7.1.2.2 DATA ANALYSIS
A data analysis technique that can be used for this process includes but is not
limited to alternatives analysis. Alternatives analysis can include reviewing
strategic funding options such as: self-funding, funding with equity, or funding
with debt. It can also include consideration of ways to acquire project resources
such as making, purchasing, renting, or leasing.
7.1.2.3 MEETINGS
Project teams may hold planning meetings to develop the cost management
plan. Attendees may include the project manager, the project sponsor, selected
project team members, selected stakeholders, anyone with responsibility for
project costs, and others as needed.
7.1.3 PLAN COST MANAGEMENT: OUTPUTS
7.1.3.1 COST MANAGEMENT PLAN
The cost management plan is a component of the project management plan
and describes how the project costs will be planned, structured, and controlled.
The cost management processes and their associated tools and techniques are
documented in the cost management plan.
For example, the cost management plan can establish the following:
Units of measure. Each unit used in measurements (such as staff hours,
staff days, or weeks for time measures; meters, liters, tons, kilometers,
or cubic yards for quantity measures; or lump sum in currency form) is
defined for each of the resources.
Level of precision. This is the degree to which cost estimates will be
rounded up or down (e.g., US$995.59 to US$1,000), based on the
scope of the activities and magnitude of the project.
Level of accuracy. The acceptable range (e.g., ±10%) used in
determining realistic cost estimates is specified, and may include an
amount for contingencies.
Organizational procedures links. The work breakdown structure
(WBS) (Section 5.4) provides the framework for the cost management
plan, allowing for consistency with the estimates, budgets, and control
of costs. The WBS component used for the project cost accounting is
called the control account. Each control account is assigned a unique
code or account number(s) that links directly to the performing
organization's accounting system.
Control thresholds. Variance thresholds for monitoring cost
performance may be specified to indicate an agreed-upon amount of
variation to be allowed before some action needs to be taken.
Thresholds are typically expressed as percentage deviations from the
baseline plan.
Rules of performance measurement. Earned value management (EVM)
rules of performance measurement are set. For example, the cost
management plan may:
Define the points in the WBS at which measurement of control
accounts will be performed;
Establish the EVM techniques (e.g., weighted milestones, fixed-
formula, percent complete, etc.) to be employed; and
Specify tracking methodologies and the EVM computation equations
for calculating projected estimate at completion (EAC) forecasts to
provide a validity check on the bottom-up EAC.
Reporting formats. The formats and frequency for the various cost
reports are defined.
Additional details. Additional details about cost management activities
include but are not limited to:
Description of strategic funding choices,
Procedure to account for fluctuations in currency exchange rates, and
Procedure for project cost recording.
For more specific information regarding earned value management, refer to
the Practice Standard for Earned Value Management – Second Edition [17].
7.2 ESTIMATE COSTS
Estimate Costs is the process of developing an approximation of the cost of
resources needed to complete project work. The key benefit of this process is
that it determines the monetary resources required for the project. This process is
performed periodically throughout the project as needed. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 7-4. Figure 7-5
depicts the data flow diagram of the process.
A cost estimate is a quantitative assessment of the likely costs for resources
required to complete the activity. It is a prediction that is based on the
information known at a given point in time. Cost estimates include the
identification and consideration of costing alternatives to initiate and complete
the project. Cost trade-offs and risks should be considered, such as make versus
buy, buy versus lease, and the sharing of resources in order to achieve optimal
costs for the project.
Cost estimates are generally expressed in units of some currency (i.e., dollars,
euros, yen, etc.), although in some instances other units of measure, such as staff
hours or staff days, are used to facilitate comparisons by eliminating the effects
of currency fluctuations.
Cost estimates should be reviewed and refined during the course of the project
to reflect additional detail as it becomes available and assumptions are tested.
The accuracy of a project estimate will increase as the project progresses through
the project life cycle. For example, a project in the initiation phase may have a
rough order of magnitude (ROM) estimate in the range of −25% to +75%. Later
in the project, as more information is known, definitive estimates could narrow
the range of accuracy to −5% to +10%. In some organizations, there are
guidelines for when such refinements can be made and the degree of confidence
or accuracy that is expected.
Costs are estimated for all resources that will be charged to the project. This
includes but is not limited to labor, materials, equipment, services, and facilities,
as well as special categories such as an inflation allowance, cost of financing, or
contingency costs. Cost estimates may be presented at the activity level or in
summary form.
7.2.1 ESTIMATE COSTS: INPUTS
7.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Cost management plan. Described in Section 7.1.3.1. The cost
management plan describes estimating methods that can be used and
the level of precision and accuracy required for the cost estimate.
Quality management plan. Described in Section 8.1.3.1. The quality
management plan describes the activities and resources necessary for
the project management team to achieve the quality objectives set for
the project.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
includes the project scope statement, WBS, and WBS dictionary:
Project scope statement. The scope statement (Section 5.3.3.1)
reflects funding constraints by period for the expenditure of project
funds or other financial assumptions and constraints.
Work breakdown structure. The WBS (Section 5.4.3.1) provides the
relationships among all the project deliverables and their various
components.
WBS dictionary. The WBS dictionary (Section 5.4.3.) and related
detailed statements of work provide an identification of the
deliverables and a description of the work in each WBS component
required to produce each deliverable.
7.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to developing cost estimates can be
applied to later phases in the project to improve the accuracy and
precision of the cost estimates.
Project schedule. Described in Section 6.5.3.2. The schedule includes
the type, quantity, and amount of time that team and physical
resources will be active on the project. The duration estimates (Section
6.4.3.1) will affect cost estimates when resources are charged per unit
of time and when there are seasonal fluctuations in costs. The schedule
also provides useful information for projects that incorporate the cost
of financing (including interest charges).
Resource requirements. Described in Section 9.2.3.1. Resource
requirements identify the types and quantities of resources required for
each work package or activity.
Risk register. Described in Section 11.2.3.1. The risk register contains
details of individual project risks that have been identified and
prioritized, and for which risk responses are required. The risk register
provides detailed information that can be used to estimate costs.
7.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Estimate Costs
process include but are not limited to:
Market conditions. These conditions describe what products, services,
and results are available in the market, from whom, and under what
terms and conditions. Regional and/or global supply and demand
conditions greatly influence resource costs.
Published commercial information. Resource cost rate information is
often available from commercial databases that track skills and human
resource costs, and provide standard costs for material and equipment.
Published seller price lists are another source of information.
Exchange rates and inflation. For large-scale projects that extend
multiple years with multiple currencies, the fluctuations of currencies
and inflation need to be understood and built into the Estimate Cost
process.
7.2.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Estimate Costs
process include but are not limited to:
Cost estimating policies,
Cost estimating templates,
Historical information and lessons learned repository.
7.2.2 ESTIMATE COSTS: TOOLS AND TECHNIQUES
7.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Previous similar projects;
Information in the industry, discipline, and application area; and
Cost estimating methods.
7.2.2.2 ANALOGOUS ESTIMATING
Described in Section 6.4.2.2. Analogous cost estimating uses values, or
attributes, of a previous project that are similar to the current project. Values and
attributes of the projects may include but are not limited to: scope, cost, budget,
duration, and measures of scale (e.g., size, weight). Comparison of these project
values, or attributes, becomes the basis for estimating the same parameter or
measurement for the current project.
7.2.2.3 PARAMETRIC ESTIMATING
Described in Section 6.4.2.3. Parametric estimating uses a statistical
relationship between relevant historical data and other variables (e.g., square
footage in construction) to calculate a cost estimate for project work. This
technique can produce higher levels of accuracy depending on the sophistication
and underlying data built into the model. Parametric cost estimates can be
applied to a total project or to segments of a project, in conjunction with other
estimating methods.
7.2.2.4 BOTTOM-UP ESTIMATING
Described in Section 6.4.2.5. Bottom-up estimating is a method of estimating
a component of work. The cost of individual work packages or activities is
estimated to the greatest level of specified detail. The detailed cost is then
summarized or “rolled up” to higher levels for subsequent reporting and tracking
purposes. The cost and accuracy of bottom-up cost estimating are typically
influenced by the size or other attributes of the individual activity or work
package.
7.2.2.5 THREE-POINT ESTIMATING
Described in Section 6.4.2.4. The accuracy of single-point cost estimates may
be improved by considering estimation uncertainty and risk and using three
estimates to define an approximate range for an activity's cost:
Most likely (cM). The cost of the activity, based on realistic effort
assessment for the required work and any predicted expenses.
Optimistic (cO). The cost based on analysis of the best-case scenario
for the activity.
Pessimistic (cP). The cost based on analysis of the worst-case scenario
for the activity.
Depending on the assumed distribution of values within the range of the three
estimates, the expected cost, cE, can be calculated using a formula. Two
commonly used formulas are triangular and beta distributions. The formulas are:
Triangular distribution. cE = (cO + cM + cP) / 3
Beta distribution. cE = (cO + 4cM + cP) / 6
Cost estimates based on three points with an assumed distribution provide an
expected cost and clarify the range of uncertainty around the expected cost.
7.2.2.6 DATA ANALYSIS
Data analysis techniques that can be used in the Estimate Costs process
include but are not limited to:
Alternatives analysis. Alternatives analysis is a technique used to
evaluate identified options in order to select which options or
approaches to use to execute and perform the work of the project. An
example would be evaluating the cost, schedule, resource, and quality
impacts of buying versus making a deliverable.
Reserve analysis. Cost estimates may include contingency reserves
(sometimes called contingency allowances) to account for cost
uncertainty. Contingency reserves are the budget within the cost
baseline that is allocated for identified risks. Contingency reserves are
often viewed as the part of the budget intended to address the known-
unknowns that can affect a project. For example, rework for some
project deliverables could be anticipated, while the amount of this
rework is unknown. Contingency reserves may be estimated to account
for this unknown amount of rework. Contingency reserves can be
provided at any level from the specific activity to the entire project.
The contingency reserve may be a percentage of the estimated cost, a
fixed number, or may be developed by using quantitative analysis
methods.
As more precise information about the project becomes available, the
contingency reserve may be used, reduced, or eliminated. Contingency
should be clearly identified in cost documentation. Contingency reserves
are part of the cost baseline and the overall funding requirements for the
project.
Cost of quality. Assumptions about costs of quality (Section 8.1.2.3)
may be used to prepare the estimates. This includes evaluating the cost
impact of additional investment in conformance versus the cost of
nonconformance. It can also include looking at short-term cost
reductions versus the implication of more frequent problems later on in
the product life cycle.
7.2.2.7 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. The project management information system can
include spreadsheets, simulation software, and statistical analysis tools to assist
with cost estimating. Such tools simplify the use of some cost-estimating
techniques and thereby facilitate rapid consideration of cost estimate
alternatives.
7.2.2.8 DECISION MAKING
The decision-making techniques that can be used in the Estimate Costs
process include but are not limited to voting. Described in Section 5.2.2.4,
voting is an assessment process having multiple alternatives with an expected
outcome in the form of future actions. These techniques are useful for engaging
team members to improve estimate accuracy and commitment to the emerging
estimates.
7.2.3 ESTIMATE COSTS: OUTPUTS
7.2.3.1 COST ESTIMATES
Cost estimates include quantitative assessments of the probable costs required
to complete project work, as well as contingency amounts to account for
identified risks, and management reserve to cover unplanned work. Cost
estimates can be presented in summary form or in detail. Costs are estimated for
all resources that are applied to the cost estimate. This includes but is not limited
to direct labor, materials, equipment, services, facilities, information technology,
and special categories such as cost of financing (including interest charges), an
inflation allowance, exchange rates, or a cost contingency reserve. Indirect costs,
if they are included in the project estimate, can be included at the activity level
or at higher levels.
7.2.3.2 BASIS OF ESTIMATES
The amount and type of additional details supporting the cost estimate vary by
application area. Regardless of the level of detail, the supporting documentation
should provide a clear and complete understanding of how the cost estimate was
derived.
Supporting detail for cost estimates may include:
Documentation of the basis of the estimate (i.e., how it was
developed),
Documentation of all assumptions made,
Documentation of any known constraints,
Documentation of identified risks included when estimating costs,
Indication of the range of possible estimates (e.g., US$10,000 (±10%)
to indicate that the item is expected to cost between a range of values),
and
Indication of the confidence level of the final estimate.
7.2.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. During the Cost
Estimates process, new assumptions may be made, new constraints
may be identified, and existing assumptions or constraints may be
revisited and changed. The assumption log should be updated with this
new information.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were efficient and
effective in developing cost estimates.
Risk register. Described in Section 11.2.3.1. The risk register may be
updated when appropriate risk responses are chosen and agreed upon
during the Estimate Cost process.
7.3 DETERMINE BUDGET
Determine Budget is the process of aggregating the estimated costs of
individual activities or work packages to establish an authorized cost baseline.
The key benefit of this process is that it determines the cost baseline against
which project performance can be monitored and controlled. This process is
performed once or at predefined points in the project. The inputs, tools and
techniques, and outputs of this process are depicted in Figure 7-6. Figure 7-7
depicts the data flow diagram of the process.
A project budget includes all the funds authorized to execute the project. The
cost baseline is the approved version of the time-phased project budget that
includes contingency reserves, but excludes management reserves.
7.3.1 DETERMINE BUDGET: INPUTS
7.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Cost management plan. Described in Section 7.1.3.1. The cost
management plan describes how the project costs will be structured
into the project budget.
Resource management plan. Described in Section 9.1.3.1. The
resource management plan provides information on rates (personnel
and other resources), estimation of travel costs, and other foreseen
costs that are necessary to estimate the overall project budget.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
includes the project scope statement, WBS, and WBS dictionary
details for cost estimation and management.
7.3.1.2 PROJECT DOCUMENTS
Examples of project documents that can be considered as inputs for this
process include but are not limited to:
Basis of estimates. Described in Section 6.4.3.2. Supporting detail for
cost estimates contained in the basis for estimates should specify any
basic assumptions dealing with the inclusion or exclusion of indirect or
other costs in the project budget.
Cost estimates. Described in Section 7.2.3.1. Cost estimates for each
activity within a work package are aggregated to obtain a cost estimate
for each work package.
Project schedule. Described in Section 6.5.3.2. The project schedule
includes planned start and finish dates for the project's activities,
milestones, work packages, and control accounts. This information can
be used to aggregate costs to the calendar periods in which the costs
are planned to be incurred.
Risk register. Described in Section 11.2.3.1. The risk register should
be reviewed to consider how to aggregate the risk response costs.
Updates to the risk register are included with project documents
updates described in Section 11.5.3.3.
7.3.1.3 BUSINESS DOCUMENTS
Described in Section 1.2.6. The business documents that can be considered as
inputs for this process include but are not limited to:
Business case. The business case identifies the critical success factors
for the project, including financial success factors.
Benefits management plan. The benefits management plan includes
the target benefits, such as net present value calculations, timeframe
for realizing benefits, and the metrics associated with the benefits.
7.3.1.4 AGREEMENTS
Described in Section 12.2.3.2. Applicable agreement information and costs
relating to products, services, or results that have been or will be purchased are
included when determining the budget.
7.3.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Estimate Costs
process include but are not limited to exchange rates. For large-scale projects
that extend multiple years with multiple currencies, the fluctuations of currencies
need to be understood and built into the Determine Budget process.
7.3.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Determine Budget
process include but are not limited to:
Existing formal and informal cost budgeting-related policies,
procedures, and guidelines;
Historical information and lessons learned repository.
Cost budgeting tools; and
Reporting methods.
7.3.2 DETERMINE BUDGET: TOOLS AND TECHNIQUES
7.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Previous similar projects;
Information in the industry, discipline, and application area;
Financial principles; and
Funding requirement and sources.
7.3.2.2 COST AGGREGATION
Cost estimates are aggregated by work packages in accordance with the WBS.
The work package cost estimates are then aggregated for the higher component
levels of the WBS (such as control accounts) and, ultimately, for the entire
project.
7.3.2.3 DATA ANALYSIS
A data analysis technique that can be used in the Determine Budget process
includes but is not limited to reserve analysis, which can establish the
management reserves for the project. Management reserves are an amount of the
project budget withheld for management control purposes and are reserved for
unforeseen work that is within scope of the project. Management reserves are
intended to address the unknown unknowns that can affect a project. The
management reserve is not included in the cost baseline but is part of the overall
project budget and funding requirements. When an amount of management
reserves is used to fund unforeseen work, the amount of management reserve
used is added to the cost baseline, thus requiring an approved change to the cost
baseline.
7.3.2.4 HISTORICAL INFORMATION REVIEW
Reviewing historical information can assist in developing parametric
estimates or analogous estimates. Historical information may include project
characteristics (parameters) to develop mathematical models to predict total
project costs. Such models may be simple (e.g., residential home construction is
based on a certain cost per square foot of space) or complex (e.g., one model of
software development costing uses multiple separate adjustment factors, each of
which has numerous points within it).
Both the cost and accuracy of analogous and parametric models can vary
widely. They are most likely to be reliable when:
Historical information used to develop the model is accurate,
Parameters used in the model are readily quantifiable, and
Models are scalable, such that they work for large projects, small
projects, and phases of a project.
7.3.2.5 FUNDING LIMIT RECONCILIATION
The expenditure of funds should be reconciled with any funding limits on the
commitment of funds for the project. A variance between the funding limits and
the planned expenditures will sometimes necessitate the rescheduling of work to
level out the rate of expenditures. This is accomplished by placing imposed date
constraints for work into the project schedule.
7.3.2.6 FINANCING
Financing entails acquiring funding for projects. It is common for long-term
infrastructure, industrial, and public services projects to seek external sources of
funds. If a project is funded externally, the funding entity may have certain
requirements that are required to be met.
7.3.3 DETERMINE BUDGET: OUTPUTS
7.3.3.1 COST BASELINE
The cost baseline is the approved version of the time-phased project budget,
excluding any management reserves, which can only be changed through formal
change control procedures. It is used as a basis for comparison to actual results.
The cost baseline is developed as a summation of the approved budgets for the
different schedule activities.
Figure 7-8 illustrates the various components of the project budget and cost
baseline. Cost estimates for the various project activities, along with any
contingency reserves (see Section 7.2.2.6) for these activities, are aggregated
into their associated work package costs. The work package cost estimates,
along with any contingency reserves estimated for the work packages, are
aggregated into control accounts. The summation of the control accounts make
up the cost baseline. Since the cost estimates that make up the cost baseline are
directly tied to the schedule activities, this enables a time-phased view of the
cost baseline, which is typically displayed in the form of an S-curve, as is
illustrated in Figure 7-9. For projects that use earned value management, the cost
baseline is referred to as the performance measurement baseline.
Management reserves (Section 7.2.2.3) are added to the cost baseline to
produce the project budget. As changes warranting the use of management
reserves arise, the change control process is used to obtain approval to move the
applicable management reserve funds into the cost baseline.
7.3.3.2 PROJECT FUNDING REQUIREMENTS
Total funding requirements and periodic funding requirements (e.g., quarterly,
annually) are derived from the cost baseline. The cost baseline will include
projected expenditures plus anticipated liabilities. Funding often occurs in
incremental amounts, and may not be evenly distributed, which appear as steps
in Figure 7-9. The total funds required are those included in the cost baseline
plus management reserves, if any. Funding requirements may include the
source(s) of the funding.
7.3.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Cost estimates. Described in Section 7.2.3.1. Cost estimates are
updated to record any additional information.
Project schedule. Described in Section 6.5.3.2. Estimated costs for
each activity may be recorded as part of the project schedule.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
7.4 CONTROL COSTS
Control Costs is the process of monitoring the status of the project to update
the project costs and managing changes to the cost baseline. The key benefit of
this process is that the cost baseline is maintained throughout the project. This
process is performed throughout the project. The inputs, tools and techniques,
and outputs of this process are depicted in Figure 7-10. Figure 7-11 depicts the
data flow diagram of the process.
Updating the budget requires knowledge of the actual costs spent to date. Any
increase to the authorized budget can only be approved through the Perform
Integrated Change Control process (Section 4.6). Monitoring the expenditure of
funds without regard to the value of work being accomplished for such
expenditures has little value to the project, other than to track the outflow of
funds. Much of the effort of cost control involves analyzing the relationship
between the consumption of project funds and the work being accomplished for
such expenditures. The key to effective cost control is the management of the
approved cost baseline.
Project cost control includes:
Influencing the factors that create changes to the authorized cost
baseline;
Ensuring that all change requests are acted on in a timely manner;
Managing the actual changes when and as they occur;
Ensuring that cost expenditures do not exceed the authorized funding
by period, by WBS component, by activity, and in total for the project;
Monitoring cost performance to isolate and understand variances from
the approved cost baseline;
Monitoring work performance against funds expended;
Preventing unapproved changes from being included in the reported
cost or resource usage;
Informing appropriate stakeholders of all approved changes and
associated cost; and
Bringing expected cost overruns within acceptable limits.
7.4.1 CONTROL COSTS: INPUTS
7.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Cost management plan. Described in Section 7.1.3.1. The cost
management plan describes how the project costs will be managed and
controlled.
Cost baseline. Described in Section 7.3.3.1. The cost baseline is
compared with actual results to determine if a change, corrective
action, or preventive action is necessary.
Performance measurement baseline. Described in Section 4.2.3.1.
When using earned value analysis, the performance measurement
baseline is compared to actual results to determine if a change,
corrective action, or preventive action is necessary.
7.4.1.2. PROJECT DOCUMENTS
Examples of project documents that can be considered as inputs for this
process include but are not limited to the lessons learned register. Described in
Section 4.4.3.1. Lessons learned earlier in the project can be applied to later
phases in the project to improve cost control.
7.4.1.3 PROJECT FUNDING REQUIREMENTS
Described in Section 7.3.3.2. The project funding requirements include
projected expenditures plus anticipated liabilities.
7.4.1.4 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on project
status such as which costs have been authorized, incurred, invoiced, and paid.
7.4.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Costs process
include but are not limited to:
Existing formal and informal cost control-related policies, procedures,
and guidelines;
Cost control tools; and
Monitoring and reporting methods to be used.
7.4.2 CONTROL COSTS: TOOLS AND TECHNIQUES
7.4.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Examples of expert judgment during the Control
Costs process include but are not limited to:
Variance analysis,
Earned value analysis,
Forecasting, and
Financial analysis.
7.4.2.2 DATA ANALYSIS
Data analysis techniques that can be used to control costs include but are not
limited to:
Earned value analysis (EVA). Earned value analysis compares the
performance measurement baseline to the actual schedule and cost
performance. EVM integrates the scope baseline with the cost baseline
and schedule baseline to form the performance measurement baseline.
EVM develops and monitors three key dimensions for each work
package and control account:
Planned value. Planned value (PV) is the authorized budget assigned
to scheduled work. It is the authorized budget planned for the work to
be accomplished for an activity or work breakdown structure (WBS)
component, not including management reserve. This budget is
allocated by phase over the life of the project, but at a given point in
time, planned value defines the physical work that should have been
accomplished. The total of the PV is sometimes referred to as the
performance measurement baseline (PMB). The total planned value
for the project is also known as budget at completion (BAC).
Earned value. Earned value (EV) is a measure of work performed
expressed in terms of the budget authorized for that work. It is the
budget associated with the authorized work that has been completed.
The EV being measured needs to be related to the PMB, and the EV
measured cannot be greater than the authorized PV budget for a
component. The EV is often used to calculate the percent complete of
a project. Progress measurement criteria should be established for
each WBS component to measure work in progress. Project managers
monitor EV, both incrementally to determine current status and
cumulatively to determine the long-term performance trends.
Actual cost. Actual cost (AC) is the realized cost incurred for the
work performed on an activity during a specific time period. It is the
total cost incurred in accomplishing the work that the EV measured.
The AC needs to correspond in definition to what was budgeted in
the PV and measured in the EV (e.g., direct hours only, direct costs
only, or all costs including indirect costs). The AC will have no upper
limit; whatever is spent to achieve the EV will be measured.
Variance analysis. Described in Section 4.5.2.2. Variance analysis, as
used in EVM, is the explanation (cause, impact, and corrective
actions) for cost (CV = EV – AC), schedule (SV = EV – PV), and
variance at completion (VAC = BAC – EAC) variances. Cost and
schedule variances are the most frequently analyzed measurements.
For projects not using formal earned value analysis, similar variance
analyses can be performed by comparing planned cost against actual
cost to identify variances between the cost baseline and actual project
performance. Further analysis can be performed to determine the cause
and degree of variance relative to the schedule baseline and any
corrective or preventive actions needed. Cost performance
measurements are used to assess the magnitude of variation to the
original cost baseline. An important aspect of project cost control
includes determining the cause and degree of variance relative to the
cost baseline (see Section 7.3.3.1) and deciding whether corrective or
preventive action is required. The percentage range of acceptable
variances will tend to decrease as more work is accomplished.
Examples of variance analysis include but are not limited to:
Schedule variance. Schedule variance (SV) is a measure of schedule
performance expressed as the difference between the earned value
and the planned value. It is the amount by which the project is ahead
or behind the planned delivery date, at a given point in time. It is a
measure of schedule performance on a project. It is equal to the
earned value (EV) minus the planned value (PV). The EVA schedule
variance is a useful metric in that it can indicate when a project is
falling behind or is ahead of its baseline schedule. The EVA schedule
variance will ultimately equal zero when the project is completed
because all of the planned values will have been earned. Schedule
variance is best used in conjunction with critical path method (CPM)
scheduling and risk management. Equation: SV = EV – PV.
Cost variance. Cost variance (CV) is the amount of budget deficit or
surplus at a given point in time, expressed as the difference between
earned value and the actual cost. It is a measure of cost performance
on a project. It is equal to the earned value (EV) minus the actual cost
(AC). The cost variance at the end of the project will be the
difference between the budget at completion (BAC) and the actual
amount spent. The CV is particularly critical because it indicates the
relationship of physical performance to the costs spent. Negative CV
is often difficult for the project to recover. Equation: CV = EV – AC.
Schedule performance index. The schedule performance index (SPI)
is a measure of schedule efficiency expressed as the ratio of earned
value to planned value. It measures how efficiently the project team
is accomplishing the work. It is sometimes used in conjunction with
the cost performance index (CPI) to forecast the final project
completion estimates. An SPI value less than 1.0 indicates less work
was completed than was planned. An SPI greater than 1.0 indicates
that more work was completed than was planned. Since the SPI
measures all project work, the performance on the critical path also
needs to be analyzed to determine whether the project will finish
ahead of or behind its planned finish date. The SPI is equal to the
ratio of the EV to the PV. Equation: SPI = EV/PV.
Cost performance index. The cost performance index (CPI) is a
measure of the cost efficiency of budgeted resources, expressed as a
ratio of earned value to actual cost. It is considered the most critical
EVA metric and measures the cost efficiency for the work completed.
A CPI value of less than 1.0 indicates a cost overrun for work
completed. A CPI value greater than 1.0 indicates a cost underrun of
performance to date. The CPI is equal to the ratio of the EV to the
AC. Equation: CPI = EV/AC.
Trend analysis. Described in Section 4.5.2.2. Trend analysis examines
project performance over time to determine if performance is
improving or deteriorating. Graphical analysis techniques are valuable
for understanding performance to date and for comparison to future
performance goals in the form of BAC versus estimate at completion
(EAC) and completion dates. Examples of the trend analysis
techniques include but are not limited to:
Charts. In earned value analysis, three parameters of planned value,
earned value, and actual cost can be monitored and reported on both a
period-by-period basis (typically weekly or monthly) and on a
cumulative basis. Figure 7-12 uses S-curves to display EV data for a
project that is performing over budget and behind the schedule.
Forecasting. As the project progresses, the project team may develop
a forecast for the estimate at completion (EAC) that may differ from
the budget at completion (BAC) based on the project performance. If
it becomes obvious that the BAC is no longer viable, the project
manager should consider the forecasted EAC. Forecasting the EAC
involves making projections of conditions and events in the project's
future based on current performance information and other
knowledge available at the time of the forecast. Forecasts are
generated, updated, and reissued based on work performance data
(Section 4.3.3.2) that is provided as the project is executed. The work
performance information covers the project's past performance and
any information that could impact the project in the future.
EACs are typically based on the actual costs incurred for work
completed, plus an estimate to complete (ETC) the remaining work. It is
incumbent on the project team to predict what it may encounter to
perform the ETC, based on its experience to date. Earned value analysis
works well in conjunction with manual forecasts of the required EAC
costs. The most common EAC forecasting approach is a manual,
bottom-up summation by the project manager and project team.
The project manager's bottom-up EAC method builds upon the actual
costs and experience incurred for the work completed, and requires a
new estimate to complete the remaining project work. Equation: EAC =
AC + Bottom-up ETC.
The project manager's manual EAC is quickly compared with a range of
calculated EACs representing various risk scenarios. When calculating
EAC values, the cumulative CPI and SPI values are typically used.
While EVM data quickly provide many statistical EACs, only three of
the more common methods are described as follows:
EAC forecast for ETC work performed at the budgeted rate.
This EAC method accepts the actual project performance to date
(whether favorable or unfavorable) as represented by the actual
costs, and predicts that all future ETC work will be accomplished
at the budgeted rate. When actual performance is unfavorable, the
assumption that future performance will improve should be
accepted only when supported by project risk analysis. Equation:
EAC = AC + (BAC – EV).
EAC forecast for ETC work performed at the present CPI. This
method assumes that what the project has experienced to date can
be expected to continue in the future. The ETC work is assumed
to be performed at the same cumulative cost performance index
(CPI) as that incurred by the project to date. Equation: EAC =
BAC / CPI.
EAC forecast for ETC work considering both SPI and CPI
factors. In this forecast, the ETC work will be performed at an
efficiency rate that considers both the cost and schedule
performance indices. This method is most useful when the project
schedule is a factor impacting the ETC effort. Variations of this
method weight the CPI and SPI at different values (e.g., 80/20,
50/50, or some other ratio) according to the project manager's
judgment. Equation: EAC = AC + [(BAC – EV) / (CPI × SPI)].
Reserve analysis. Described in Section 7.2.2.6. During cost control,
reserve analysis is used to monitor the status of contingency and
management reserves for the project to determine if these reserves are
still needed or if additional reserves need to be requested. As work on
the project progresses, these reserves may be used as planned to cover
the cost of risk responses or other contingencies. Conversely, when
opportunities are captured and resulting in cost savings, funds may be
added to the contingency amount, or taken from the project as
margin/profit.
If the identified risks do not occur, the unused contingency reserves may be
removed from the project budget to free up resources for other projects or
operations. Additional risk analysis during the project may reveal a need to
request that additional reserves be added to the project budget.
7.4.2.3 TO-COMPLETE PERFORMANCE INDEX
The to-complete performance index (TCPI) is a measure of the cost
performance that is required to be achieved with the remaining resources in
order to meet a specified management goal, expressed as the ratio of the cost to
finish the outstanding work to the remaining budget. TCPI is the calculated cost
performance index that is achieved on the remaining work to meet a specified
management goal, such as the BAC or the EAC. If it becomes obvious that the
BAC is no longer viable, the project manager should consider the forecasted
EAC. Once approved, the EAC may replace the BAC in the TCPI calculation.
The equation for the TCPI based on the BAC: (BAC – EV) / (BAC – AC).
The TCPI is conceptually displayed in Figure 7-13. The equation for the TCPI
is shown in the lower left as the work remaining (defined as the BAC minus the
EV) divided by the funds remaining (which can be either the BAC minus the
AC, or the EAC minus the AC).
If the cumulative CPI falls below the baseline (as shown in Figure 7-13), all
future work of the project will need to be performed immediately in the range of
the TCPI (BAC) (as reflected in the top line of Figure 7-13) to stay within the
authorized BAC. Whether this level of performance is achievable is a judgment
call based on a number of considerations, including risk, time remaining in the
project, and technical performance. This level of performance is displayed as the
TCPI (EAC) line. The equation for the TCPI is based on the EAC: (BAC – EV) /
(EAC – AC). The EVM formulas are provided in Table 7-1.
7.4.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems are
often used to monitor the three EVM dimensions (PV, EV, and AC), to display
graphical trends, and to forecast a range of possible final project results.
7.4.3 CONTROL COSTS: OUTPUTS
7.4.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how the project work is performing compared to the cost
baseline. Variances in the work performed and the cost of the work are evaluated
at the work package level and control account level. For projects using earned
value analysis, CV, CPI, EAC, VAC, and TCPI are documented for inclusion in
work performance reports (Section 4.5.3.1).
7.4.3.2 COST FORECASTS
Either a calculated EAC value or a bottom-up EAC value is documented and
communicated to stakeholders.
7.4.3.3 CHANGE REQUESTS
Described in Section 4.3.3.4. Analysis of project performance may result in a
change request to the cost and schedule baselines or other components of the
project management plan. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
7.4.3.4 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Cost management plan. Described in Section 7.1.3.1. Changes to the
cost management plan, such as changes to control thresholds or
specified levels of accuracy required in managing the project's cost,
are incorporated in response to feedback from relevant stakeholders.
Cost baseline. Described in Section 7.3.3.1. Changes to the cost
baseline are incorporated in response to approved changes in scope,
resources, or cost estimates. In some cases, cost variances can be so
severe that a revised cost baseline is needed to provide a realistic basis
for performance measurement.
Performance measurement baseline. Described in Section 4.2.3.1.
Changes to the performance measurement baseline are incorporated in
response to approved changes in scope, schedule performance, or cost
estimates. In some cases, the performance variances can be so severe
that a change request is put forth to revise the performance
measurement baseline to provide a realistic basis for performance
measurement.
7.4.3.5 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. Cost performance may
indicate the need to revise assumptions on resource productivity and
other factors influencing cost performance.
Basis of estimates. Described in Section 6.4.3.2. Cost performance
may indicate the need to revisit the original basis of estimates.
Cost estimates. Described in Section 7.2.3.1. Cost estimates may need
to be updated to reflect the actual cost efficiency for the project.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were effective in
maintaining the budget, variance analysis, earned value analysis,
forecasting, and corrective actions that were used to respond to cost
variances.
Risk register. Described in Section 11.2.3.1. The risk register may be
updated if the cost variances have crossed, or are likely to cross, the
cost threshold.
8
PROJECT QUALITY MANAGEMENT
Project Quality Management includes the processes for incorporating the
organization's quality policy regarding planning, managing, and controlling
project and product quality requirements in order to meet stakeholders’
objectives. Project Quality Management also supports continuous process
improvement activities as undertaken on behalf of the performing organization.
The Project Quality Management processes are:
8.1 Plan Quality Management—The process of identifying quality
requirements and/or standards for the project and its deliverables, and
documenting how the project will demonstrate compliance with quality
requirements and/or standards.
8.2 Manage Quality—The process of translating the quality management plan
into executable quality activities that incorporate the organization's quality
policies into the project.
8.3 Control Quality—The process of monitoring and recording the results of
executing the quality management activities to assess performance and ensure
the project outputs are complete, correct, and meet customer expectations.
Figure 8-1 provides an overview of the Project Quality Management
processes. The Project Quality Management processes are presented as discrete
processes with defined interfaces while, in practice, they overlap and interact in
ways that cannot be completely detailed in the PMBOK® Guide. In addition,
these quality processes may differ within industries and companies.
Figure 8-2 provides an overview of the major inputs and outputs of the Project
Quality Management processes and the interrelations of these processes in the
Project Quality Management Knowledge Area. The Plan Quality Management
process is concerned with the quality that the work needs to have. Manage
Quality is concerned with managing the quality processes throughout the project.
During the Manage Quality process, quality requirements identified during the
Plan Quality Management process are turned into test and evaluation
instruments, which are then applied during the Control Quality process to verify
these quality requirements are met by the project. Control Quality is concerned
with comparing the work results with the quality requirements to ensure the
result is acceptable. There are two outputs specific to the Project Quality
Management Knowledge Area that are used by other Knowledge Areas: verified
deliverables and quality reports.
KEY CONCEPTS FOR PROJECT QUALITY MANAGEMENT
Project Quality Management addresses the management of the project and the
deliverables of the project. It applies to all projects, regardless of the nature of
their deliverables. Quality measures and techniques are specific to the type of
deliverables being produced by the project. For example, the project quality
management of software deliverables may use different approaches and
measures from those used when building a nuclear power plant. In either case,
failure to meet the quality requirements can have serious negative consequences
for any or all of the project's stakeholders. For example:
Meeting customer requirements by overworking the project team may
result in decreased profits and increased levels of overall project risks,
employee attrition, errors, or rework.
Meeting project schedule objectives by rushing planned quality
inspections may result in undetected errors, decreased profits, and
increased post-implementation risks.
Quality and grade are not the same concepts. Quality as a delivered
performance or result is “the degree to which a set of inherent characteristics
fulfill requirements” (ISO 9000 [18].). Grade as a design intent is a category
assigned to deliverables having the same functional use but different technical
characteristics. The project manager and the project management team are
responsible for managing the trade-offs associated with delivering the required
levels of both quality and grade. While a quality level that fails to meet quality
requirements is always a problem, a low-grade product may not be a problem.
For example:
It may not be a problem if a suitable low-grade product (one with a
limited number of features) is of high quality (no obvious defects). In
this example, the product would be appropriate for its general purpose
of use.
It may be a problem if a high-grade product (one with numerous
features) is of low quality (many defects). In essence, a high-grade
feature set would prove ineffective and/or inefficient due to low
quality.
Prevention is preferred over inspection. It is better to design quality into
deliverables, rather than to find quality issues during inspection. The cost of
preventing mistakes is generally much less than the cost of correcting mistakes
when they are found by inspection or during usage.
Depending on the project and the industry area, the project team may need a
working knowledge of statistical control processes to evaluate data contained in
the Control Quality outputs. The team should know the differences between the
following pairs of terms:
Prevention (keeping errors out of the process) and inspection (keeping
errors out of the hands of the customer);
Attribute sampling (the result either conforms or does not conform)
and variable sampling (the result is rated on a continuous scale that
measures the degree of conformity); and
Tolerances (specified range of acceptable results) and control limits
(that identify the boundaries of common variation in a statistically
stable process or process performance).
The cost of quality (COQ) includes all costs incurred over the life of the
product by investment in preventing nonconformance to requirements,
appraising the product or service for conformance to requirements, and failing to
meet requirements (rework). Failure costs are often categorized into internal
(found by the project team) and external (found by the customer). Failure costs
are also called the cost of poor quality. Section 8.1.2.3 provides some examples
to consider in each area. Organizations choose to invest in defect prevention
because of the benefits over the life of the product. Because projects are
temporary, decisions about the COQ over a product's life cycle are often the
concern of program management, portfolio management, the PMO, or
operations.
There are five levels of increasingly effective quality management as follows:
Usually, the most expensive approach is to let the customer find the
defects. This approach can lead to warranty issues, recalls, loss of
reputation, and rework costs.
Detect and correct the defects before the deliverables are sent to the
customer as part of the quality control process. The control quality
process has related costs, which are mainly the appraisal costs and
internal failure costs.
Use quality assurance to examine and correct the process itself and not
just special defects.
Incorporate quality into the planning and designing of the project and
product.
Create a culture throughout the organization that is aware and
committed to quality in processes and products.
TRENDS AND EMERGING PRACTICES IN PROJECT QUALITY
MANAGEMENT
Modern quality management approaches seek to minimize variation and to
deliver results that meet defined stakeholder requirements. Trends in Project
Quality Management include but are not limited to:
Customer satisfaction. Understand, evaluate, define, and manage
requirements so that customer expectations are met. This requires a
combination of conformance to requirements (to ensure the project
produces what it was created to produce) and fitness for use (the
product or service needs to satisfy the real needs). In agile
environments, stakeholder engagement with the team ensures customer
satisfaction is maintained throughout the project.
Continual improvement. The plan-do-check-act (PDCA) cycle is the
basis for quality improvement as defined by Shewhart and modified by
Deming. In addition, quality improvement initiatives such as total
quality management (TQM), Six Sigma, and Lean Six Sigma may
improve both the quality of project management, as well as the quality
of the end product, service, or result.
Management responsibility. Success requires the participation of all
members of the project team. Management retains, within its
responsibility for quality, a related responsibility to provide suitable
resources at adequate capacities.
Mutually beneficial partnership with suppliers. An organization and its
suppliers are interdependent. Relationships based on partnership and
cooperation with the supplier are more beneficial to the organization
and to the suppliers than traditional supplier management. The
organization should prefer long-term relationships over short-term
gains. A mutually beneficial relationship enhances the ability for both
the organization and the suppliers to create value for each other,
enhances the joint responses to customer needs and expectations, and
optimizes costs and resources.
TAILORING CONSIDERATIONS
Each project is unique; therefore, the project manager will need to tailor the
way Project Quality Management processes are applied. Considerations for
tailoring include but are not limited to:
Policy compliance and auditing. What quality policies and procedures
exist in the organization? What quality tools, techniques, and
templates are used in the organization?
Standards and regulatory compliance. Are there any specific quality
standards in the industry that need to be applied? Are there any
specific governmental, legal, or regulatory constraints that need to be
taken into consideration?
Continuous improvement. How will quality improvement be managed
in the project? Is it managed at the organizational level or at the level
of each project?
Stakeholder engagement. Is there a collaborative environment for
stakeholders and suppliers?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
In order to navigate changes, agile methods call for frequent quality and
review steps built in throughout the project rather than toward the end of the
project.
Recurring retrospectives regularly check on the effectiveness of the quality
processes. They look for the root cause of issues then suggest trials of new
approaches to improve quality. Subsequent retrospectives evaluate any trial
processes to determine if they are working and should be continued or new
adjusting or should be dropped from use.
In order to facilitate frequent, incremental delivery, agile methods focus on
small batches of work, incorporating as many elements of project deliverables as
possible. Small batch systems aim to uncover inconsistencies and quality issues
earlier in the project life cycle when the overall costs of change are lower.
8.1 PLAN QUALITY MANAGEMENT
Plan Quality Management is the process of identifying quality requirements
and/or standards for the project and its deliverables, and documenting how the
project will demonstrate compliance with quality requirements and/or standards.
The key benefit of this process is that it provides guidance and direction on how
quality will be managed and verified throughout the project. This process is
performed once or at predefined points in the project. The inputs and outputs of
this process are depicted in Figure 8.3. Figure 8.4 depicts the data flow diagram
for the process.
Quality planning should be performed in parallel with the other planning
processes. For example, changes proposed in the deliverables in order to meet
identified quality standards may require cost or schedule adjustments and a
detailed risk analysis of the impact to plans.
The quality planning techniques discussed here are those used most frequently
on projects. There are many others that may be useful on certain projects or in
specific application areas.
8.1.1 PLAN QUALITY MANAGEMENT: INPUTS
8.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter provides the high-level
project description and product characteristics. It also contains the project
approval requirements, measurable project objectives, and related success
criteria that will influence the quality management of the project.
8.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan provides the approach for identifying,
analyzing, and managing the requirements that the quality
management plan and quality metrics will reference.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan provides the approach for identifying, analyzing,
and monitoring risks. The information in the risk management plan
and quality management plan work together to successfully deliver
product and project success.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan provides the method for documenting the
stakeholders’ needs and expectations that provide the foundation for
quality management.
Scope baseline. Described in Section 5.4.3.1. The WBS along with the
deliverables documented in the project scope statement are considered
while determining which quality standards and objectives are suitable
for the project, and which project deliverables and processes will be
subjected to quality review. The scope statement includes the
acceptance criteria for the deliverables. The definition of acceptance
criteria may significantly increase or decrease quality costs and,
therefore, project costs. Satisfying all acceptance criteria implies the
needs of the stakeholders have been met.
8.1.1.3 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log has
all the assumptions and constraints regarding quality requirements and
standard compliance.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation captures the requirements that the
project and product should attain to meet stakeholder expectations.
The components of the requirements documentation include but are
not limited to project and product quality requirements. Requirements
are used by the project team to help plan how quality control will be
implemented on the project.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix links product requirements to
deliverables and helps to ensure each requirement in the requirements
documentation is tested. The matrix provides an overview of the tests
required to verify the requirements.
Risk register. Described in Section 11.2.3.1. The risk register contains
information on threats and opportunities that may impact quality
requirements.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register helps to identify stakeholders who have a particular interest in
or impact on quality, with the emphasis on the customer and project
sponsor needs and expectations.
8.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Quality
Management process include but are not limited to:
Governmental agency regulations;
Rules, standards, and guidelines specific to the application area;
Geographic distribution;
Organizational structure;
Marketplace conditions;
Working or operating conditions of the project or its deliverables; and
Cultural perceptions.
8.1.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Quality
Management process include but are not limited to:
Organizational quality management system including policies,
procedures, and guidelines;
Quality templates such as check sheets, traceability matrix, and others;
and
Historical databases and lessons learned repository.
8.1.2 PLAN QUALITY MANAGEMENT: TOOLS AND
TECHNIQUES
8.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Quality assurance,
Quality control,
Quality measurements,
Quality improvements, and
Quality systems.
8.1.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Benchmarking. Benchmarking involves comparing actual or planned
project practices or the project's quality standards to those of
comparable projects to identify best practices, generate ideas for
improvement, and provide a basis for measuring performance.
Benchmarked projects may exist within the performing organization or
outside of it, or can be within the same application area or other
application area. Benchmarking allows for analogies from projects in a
different application area or different industries to be made.
Brainstorming. Described in Section 4.1.2.2. Brainstorming can be
used to gather data creatively from a group of team members or
subject matter experts to develop the quality management plan that
best fits the upcoming project.
Interviews. Described in Section 5.2.2.2. Project and product quality
needs and expectations, implicit and explicit, formal and informal, can
be identified by interviewing experienced project participants,
stakeholders, and subject matter experts. Interviews should be
conducted in an environment of trust and confidentiality to encourage
honest and unbiased contributions.
8.1.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Cost-benefit analysis. A cost-benefit analysis is a financial analysis
tool used to estimate the strengths and weaknesses of alternatives in
order to determine the best alternative in terms of benefits provided. A
cost-benefit analysis will help the project manager determine if the
planned quality activities are cost effective. The primary benefits of
meeting quality requirements include less rework, higher productivity,
lower costs, increased stakeholder satisfaction, and increased
profitability. A cost-benefit analysis for each quality activity compares
the cost of the quality step to the expected benefit.
Cost of quality. The cost of quality (COQ) associated with a project
consists of one or more of the following costs (Figure 8-5 lists
examples for each cost group):
Prevention costs. Costs related to the prevention of poor quality in
the products, deliverables, or services of the specific project.
Appraisal costs. Costs related to evaluating, measuring, auditing, and
testing the products, deliverables, or services of the specific project.
Failure costs (internal/external). Costs related to nonconformance of
the products, deliverables, or services to the needs or expectations of
the stakeholders.
The optimal COQ is one that reflects the appropriate balance for investing
in the cost of prevention and appraisal to avoid failure costs. Models show
that there is an optimal quality cost for projects, where investing in
additional prevention/appraisal costs is neither beneficial nor cost effective.
8.1.2.4 DECISION MAKING
A decision-making technique that can be used for this process includes but is
not limited to multicriteria decision analysis. Multicriteria decision analysis tools
(e.g., prioritization matrix) can be used to identify the key issues and suitable
alternatives to be prioritized as a set of decisions for implementation. Criteria are
prioritized and weighted before being applied to all available alternatives to
obtain a mathematical score for each alternative. The alternatives are then ranked
by score. As used in this process, it can help prioritize quality metrics.
8.1.2.5 DATA REPRESENTATION
Data representation techniques that can be used for this process include but
are not limited to:
Flowcharts. Flowcharts are also referred to as process maps because
they display the sequence of steps and the branching possibilities that
exist for a process that transforms one or more inputs into one or more
outputs. Flowcharts show the activities, decision points, branching
loops, parallel paths, and the overall order of processing by mapping
the operational details of procedures that exist within a horizontal
value chain. One version of a value chain, known as a SIPOC
(suppliers, inputs, process, outputs, and customers) model, is shown in
Figure 8-6. Flowcharts may prove useful in understanding and
estimating the cost of quality for a process. Information is obtained by
using the workflow branching logic and associated relative frequencies
to estimate the expected monetary value for the conformance and
nonconformance work required to deliver the expected conforming
output. When flowcharts are used to represent the steps in a process,
they are sometimes called process flows or process flow diagrams and
they can be used for process improvement as well as identifying where
quality defects can occur or where to incorporate quality checks.
Logical data model. Logical data models are a visual representation of
an organization's data, described in business language and independent
of any specific technology. The logical data model can be used to
identify where data integrity or other quality issues can arise.
Matrix diagrams. Matrix diagrams help find the strength of
relationships among different factors, causes, and objectives that exist
between the rows and columns that form the matrix. Depending on
how many factors may be compared, the project manager can use
different shapes of matrix diagrams; for example, L, T, Y, X, C, and
roof–shaped. In this process they facilitate identifying the key quality
metrics that are important for the success of the project.
Mind mapping. Described in Section 5.2.2.3. Mind mapping is a
diagrammatic method used to visually organizing information. A mind
map in quality is often created around a single quality concept, drawn
as an image in the center of a blank landscape page, to which
associated representations of ideas such as images, words, and parts of
words are added. The mind-mapping technique may help in the rapid
gathering of project quality requirements, constraints, dependencies,
and relationships.
8.1.2.6 TEST AND INSPECTION PLANNING
During the planning phase, the project manager and the project team
determine how to test or inspect the product, deliverable, or service to meet the
stakeholders’ needs and expectations, as well as how to meet the goal for the
product's performance and reliability. The tests and inspections are industry
dependent and can include, for example, alpha and beta tests in software
projects, strength tests in construction projects, inspection in manufacturing, and
field tests and nondestructive tests in engineering.
8.1.2.7 MEETINGS
Project teams may hold planning meetings to develop the quality management
plan. Attendees can include the project manager, the project sponsor, selected
project team members, selected stakeholders, anyone with responsibility for
project quality management activities, and others as needed.
8.1.3 PLAN QUALITY MANAGEMENT: OUTPUTS
8.1.3.1 QUALITY MANAGEMENT PLAN
The quality management plan is a component of the project management plan
that describes how applicable policies, procedures, and guidelines will be
implemented to achieve the quality objectives. It describes the activities and
resources necessary for the project management team to achieve the quality
objectives set for the project. The quality management plan may be formal or
informal, detailed, or broadly framed. The style and detail of the quality
management plan are determined by the requirements of the project. The quality
management plan should be reviewed early in the project to ensure that decisions
are based on accurate information. The benefits of this review can include a
sharper focus on the project's value proposition, reductions in costs, and less
frequent schedule overruns that are caused by rework.
The quality management plan may include but is not limited to the following
components:
Quality standards that will be used by the project;
Quality objectives of the project;
Quality roles and responsibilities;
Project deliverables and processes subject to quality review;
Quality control and quality management activities planned for the
project;
Quality tools that will be used for the project; and
Major procedures relevant for the project, such as dealing with
nonconformance, corrective actions procedures, and continuous
improvement procedures.
8.1.3.2 QUALITY METRICS
A quality metric specifically describes a project or product attribute and how
the Control Quality process will verify compliance to it. Some examples of
quality metrics include percentage of tasks completed on time, cost performance
measured by CPI, failure rate, number of defects identified per day, total
downtime per month, errors found per line of code, customer satisfaction scores,
and percentage of requirements covered by the test plan as a measure of test
coverage.
8.1.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Risk management plan. Described in Section 11.1.3.1. Decisions on
the quality management approach may require changes to the agreed-
upon approach to managing risk on the project, and these will be
recorded in the risk management plan.
Scope baseline. Described in Section 5.4.3.1. The scope baseline may
change as a result of this process if specific quality management
activities need to be added. The WBS dictionary also records quality
requirements, which may need updating.
8.1.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
in the quality planning process.
Requirements traceability matrix. Described in Section 5.2.3.2. Where
quality requirements are specified by this process, they are recorded in
the requirements traceability matrix.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
Stakeholder register. Described in Section 13.1.3.1. Where additional
information on existing or new stakeholders is gathered as a result of
this process, it is recorded in the stakeholder register.
8.2 MANAGE QUALITY
Manage Quality is the process of translating the quality management plan into
executable quality activities that incorporate the organization's quality policies
into the project. The key benefits of this process are that it increases the
probability of meeting the quality objectives as well as identifying ineffective
processes and causes of poor quality. Manage Quality uses the data and results
from the control quality process to reflect the overall quality status of the project
to the stakeholders. This process is performed throughout the project.
The inputs, tools and techniques, and outputs of this process are depicted in
Figure 8-7. Figure 8-8 depicts the data flow diagram of the process.
Manage Quality is sometimes called quality assurance, although Manage
Quality has a broader definition than quality assurance as it is used in nonproject
work. In project management, the focus of quality assurance is on the processes
used in the project. Quality assurance is about using project processes
effectively. It involves following and meeting standards to assure stakeholders
that the final product will meet their needs, expectations, and requirements.
Manage Quality includes all the quality assurance activities, and is also
concerned with the product design aspects and process improvements. Manage
Quality work will fall under the conformance work category in the cost of
quality framework.
The Manage Quality process implements a set of planned and systematic acts
and processes defined within the project's quality management plan that helps to:
Design an optimal and mature product by implementing specific
design guidelines that address specific aspects of the product,
Build confidence that a future output will be completed in a manner
that meets the specified requirements and expectations through quality
assurance tools and techniques such as quality audits and failure
analysis,
Confirm that the quality processes are used and that their use meets the
quality objectives of the project, and
Improve the efficiency and effectiveness of processes and activities to
achieve better results and performance and enhance stakeholders’
satisfaction.
The project manager and project team may use the organization's quality
assurance department, or other organizational functions, to execute some of the
Manage Quality activities such as failure analysis, design of experiments, and
quality improvement. Quality assurance departments usually have cross-
organizational experience in using quality tools and techniques and are a good
resource for the project.
Manage Quality is considered the work of everybody—the project manager,
the project team, the project sponsor, the management of the performing
organization, and even the customer. All of these have roles in managing quality
in the project, though the roles differ in size and effort. The level of participation
in the quality management effort may differ between industries and project
management styles. In agile projects, quality management is performed by all
team members throughout the project, but in traditional projects, quality
management is often the responsibility of specific team members.
8.2.1 MANAGE QUALITY: INPUTS
8.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the quality management plan. Described in Section 8.1.3.1,
the quality management plan defines the acceptable level of project and product
quality and describes how to ensure this level of quality in its deliverables and
processes. The quality management plan also describes what to do with
nonconforming products and what corrective action to implement.
8.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to managing quality can be applied to
later phases in the project to improve the efficiency and effectiveness
of managing quality.
Quality control measurements. Described in Section 8.3.3.1. Quality
control measurements are used to analyze and evaluate the quality of
the processes and deliverables of the project against the standards of
the performing organization or the requirements specified. Quality
control measurements can also compare the processes used to create
the measurements and validate actual measurements to determine their
level of correctness.
Quality metrics. Described in Section 8.1.3.2. Quality metrics are
verified as part of the Control Quality process. The Manage Quality
process uses these quality metrics as a basis for the development of
test scenarios for the project and its deliverables and as a basis for
improvement initiatives.
Risk report. Described in Section 11.2.3.2. Risk report is used in the
Manage Quality process to identify sources of overall project risk and
the most important drivers of overall risk exposure that can impact the
quality objectives of the project.
8.2.1.3 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Manage Quality
process include but are not limited to:
Organizational quality management system that includes policies,
procedures, and guidelines;
Quality templates such as check sheets, traceability matrix, test plans,
test documents, and others;
Results from previous audits; and
Lessons learned repository with information from similar projects.
8.2.2 MANAGE QUALITY: TOOLS AND TECHNIQUES
8.2.2.1 DATA GATHERING
A data-gathering technique that can be used for this process includes but is not
limited to checklists (see Section 11.2.2.2). A checklist is a structured tool,
usually component-specific, used to verify that a set of required steps has been
performed or to check if a list of requirements has been satisfied. Based on the
project's requirements and practices, checklists may be simple or complex. Many
organizations have standardized checklists available to ensure consistency in
frequently performed tasks. In some application areas, checklists are also
available from professional associations or commercial service providers.
Quality checklists should incorporate the acceptance criteria included in the
scope baseline.
8.2.2.2 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Alternatives analysis. Described in Section 9.2.2.5. This technique is
used to evaluate identified options in order to select which different
quality options or approaches are most appropriate to use.
Document analysis. Described in Section 5.2.2.3. The analysis of
different documents produced as part of the output of project control
processes, such as quality reports, test reports, performance reports,
and variance analysis, can point to and focus on processes that may be
out of control and may jeopardize meeting the specified requirements
or stakeholders’ expectations.
Process analysis. Process analysis identifies opportunities for process
improvements. This analysis also examines problems, constraints, and
non-value-added activities that occur during a process.
Root cause analysis (RCA). Root cause analysis is an analytical
technique used to determine the basic underlying reason that causes a
variance, defect, or risk. A root cause may underlie more than one
variance, defect, or risk. It may also be used as a technique for
identifying root causes of a problem and solving them. When all root
causes for a problem are removed, the problem does not recur.
8.2.2.3 DECISION MAKING
A decision-making technique that can be used for this process includes but is
not limited to multicriteria decision analysis. Described in Section 8.1.2.4.
Multicriteria decision making is used to evaluate several criteria when discussing
alternatives that impact project or product quality. Project decisions can include
choosing among different implementation scenarios or suppliers. Product
decisions can include evaluating the life cycle cost, schedule, stakeholder
satisfaction, and risks associated with resolving product defects.
8.2.2.4 DATA REPRESENTATION
Data representation techniques that can be used for this process include but
are not limited to:
Affinity diagrams. Described in Section 5.2.2.5. Affinity diagrams can
organize potential causes of defects into groups showing areas that
should be focused on the most.
Cause-and-effect diagrams. Cause-and-effect diagrams are also known
as fishbone diagrams, why-why diagrams, or Ishikawa diagrams. This
type of diagram breaks down the causes of the problem statement
identified into discrete branches, helping to identify the main or root
cause of the problem. Figure 8-9 is an example of a cause-and-effect
diagram.
Flowcharts. Described in Section 8.1.2.5. Flowcharts show a series of
steps that lead to a defect.
Histograms. Histograms show a graphical representation of numerical
data. Histograms can show the number of defects per deliverable, a
ranking of the cause of defects, the number of times each process is
noncompliant, or other representations of project or product defects.
Matrix diagrams. Described in Section 8.1.2.5. The matrix diagram
seeks to show the strength of relationships among factors, causes, and
objectives that exist between the rows and columns that form the
matrix.
Scatter diagrams. A scatter diagram is a graph that shows the
relationship between two variables. Scatter diagrams can demonstrate
a relationship between any element of a process, environment, or
activity on one axis and a quality defect on the other axis.
8.2.2.5 AUDITS
An audit is a structured, independent process used to determine if project
activities comply with organizational and project policies, processes, and
procedures. A quality audit is usually conducted by a team external to the
project, such as the organization's internal audit department, PMO, or by an
auditor external to the organization. Quality audit objectives may include but are
not limited to:
Identifying all good and best practices being implemented;
Identifying all nonconformity, gaps, and shortcomings;
Sharing good practices introduced or implemented in similar projects
in the organization and/or industry;
Proactively offering assistance in a positive manner to improve the
implementation of processes to help raise team productivity; and
Highlighting contributions of each audit in the lessons learned
repository of the organization.
The subsequent effort to correct any deficiencies should result in a reduced
cost of quality and an increase in sponsor or customer acceptance of the project's
product. Quality audits may be scheduled or random, and may be conducted by
internal or external auditors.
Quality audits can confirm the implementation of approved change requests
including updates, corrective actions, defect repairs, and preventive actions.
8.2.2.6 DESIGN FOR X
Design for X (DfX) is a set of technical guidelines that may be applied during
the design of a product for the optimization of a specific aspect of the design.
DfX can control or even improve the product's final characteristics. The X in
DfX can be different aspects of product development, such as reliability,
deployment, assembly, manufacturing, cost, service, usability, safety, and
quality. Using the DfX may result in cost reduction, quality improvement, better
performance, and customer satisfaction.
8.2.2.7 PROBLEM SOLVING
Problem solving entails finding solutions for issues or challenges. It can
include gathering additional information, critical thinking, creative, quantitative
and/or logical approaches. Effective and systematic problem solving is a
fundamental element in quality assurance and quality improvement. Problems
can arise as a result of the Control Quality process or from quality audits and can
be associated with a process or deliverable. Using a structured problem-solving
method will help eliminate the problem and develop a long-lasting solution.
Problem-solving methods generally include the following elements:
Defining the problem,
Identifying the root-cause,
Generating possible solutions,
Choosing the best solution,
Implementing the solution, and
Verifying solution effectiveness.
8.2.2.8 QUALITY IMPROVEMENT METHODS
Quality improvements can occur based on findings and recommendations
from quality control processes, the findings of the quality audits, or problem
solving in the Manage Quality process. Plan-do-check-act and Six Sigma are two
of the most common quality improvement tools used to analyze and evaluate
opportunities for improvement.
8.2.3 MANAGE QUALITY: OUTPUTS
8.2.3.1 QUALITY REPORTS
The quality reports can be graphical, numerical, or qualitative. The
information provided can be used by other processes and departments to take
corrective actions in order to achieve the project quality expectations. The
information presented in the quality reports may include all quality management
issues escalated by the team; recommendations for process, project, and product
improvements; corrective actions recommendations (including rework,
defect/bugs repair, 100% inspection, and more); and the summary of findings
from the Control Quality process.
8.2.3.2 TEST AND EVALUATION DOCUMENTS
Test and evaluation documents can be created based on industry needs and the
organization's templates. They are inputs to the Control Quality process and are
used to evaluate the achievement of quality objectives. These documents may
include dedicated checklists and detailed requirements traceability matrices as
part of the document.
8.2.3.3 CHANGE REQUESTS
Described in Section 4.3.3.4. If changes occur during the Manage Quality
process that impact any of the components of the project management plan,
project documents, or project or product management processes, the project
manager should submit a change request and follow the Perform Integrated
Change Control process as defined in Section 4.6.
8.2.3.4 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Quality management plan. Described in Section 8.1.3.1. The agreed-
upon approach to managing quality may need to be modified due to
the actual results.
Scope baseline. Described in Section 5.4.3.1. The scope baseline may
change as a result of specific quality management activities.
Schedule baseline. Described in Section 6.5.3.1. The schedule baseline
may change as a result of specific quality management activities.
Cost baseline. Described in Section 7.3.3.1. The cost baseline may
change as a result of specific quality management activities.
8.2.3.5 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. New issues raised as a result of
this process are recorded in the issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well for the managing quality.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
8.3 CONTROL QUALITY
Control Quality is the process of monitoring and recording results of
executing the quality management activities in order to assess performance and
ensure the project outputs are complete, correct, and meet customer
expectations. The key benefit of this process is verifying that project deliverables
and work meet the requirements specified by key stakeholders for final
acceptance. The Control Quality process determines if the project outputs do
what they were intended to do. Those outputs need to comply with all applicable
standards, requirements, regulations, and specifications. This process is
performed throughout the project.
The inputs, tools and techniques, and outputs of this process are depicted in
Figure 8-10. Figure 8-11 depicts the data flow diagram of the process.
The Control Quality process is performed to measure the completeness,
compliance, and fitness for use of a product or service prior to user acceptance
and final delivery. This is done by measuring all steps, attributes, and variables
used to verify conformance or compliance to the specifications stated during the
planning stage.
Quality control should be performed throughout the project to formally
demonstrate, with reliable data, that the sponsor's and/or customer's acceptance
criteria have been met.
The level of effort to control quality and the degree of implementation may
differ between industries and project management styles; in pharmaceutical,
health, transportation, and nuclear industries, for example, there may be stricter
quality control procedures compared to other industries, and the effort needed to
meet the standards may be extensive. For example, in agile projects, the Control
Quality activities may be performed by all team members throughout the project
life cycle. In waterfall model-based projects, the quality control activities are
performed at specific times, toward the end of the project or phase, by specified
team members.
8.3.1 CONTROL QUALITY: INPUTS
8.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the quality management plan. Described in Section 8.1.3.1,
the quality management plan defines how quality control will be performed
within the project.
8.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve quality control.
Quality metrics. Described in Section 8.1.3.2. A quality metric
specifically describes a project or product attribute and how the
Control Quality process will verify compliance to it.
Test and evaluation documents. Described in Section 8.2.3.2. Test and
evaluation documents are used to evaluate achievement of the quality
objectives.
8.3.1.3 APPROVED CHANGE REQUESTS
Described in Section 4.6.3.1. As part of the Perform Integrated Change
Control process, a change log update indicates that some changes are approved
and some are not. Approved change requests may include modifications such as
defect repairs, revised work methods, and revised schedules. Partial change
completion may result in inconsistencies and later delays due to incomplete steps
or corrections. The implementation of approved changes should be verified,
confirmed for completeness, retested, and certified as correct.
8.3.1.4 DELIVERABLES
A deliverable is any unique and verifiable product, result, or capability to
perform a service that is required to be produced to complete a process, phase, or
project. Deliverables that are outputs from the Direct and Manage Project Work
process are inspected and compared to the acceptance criteria defined in the
project scope statement.
8.3.1.5 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on product
status such as observations, quality metrics, and measurements for technical
performance, as well as project quality information on schedule performance and
cost performance.
8.3.1.6 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Control Quality
process include but are not limited to:
Project management information system; quality management
software can be used to track errors and variations in processes or
deliverables;
Governmental agency regulations; and
Rules, standards, and guidelines specific to the application area.
8.3.1.7 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Quality
process include but are not limited to:
Quality standards and policies;
Quality templates, for example, check sheets, checklists, etc. and;
Issue and defect reporting procedures and communication policies.
8.3.2 CONTROL QUALITY: TOOLS AND TECHNIQUES
8.3.2.1 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Checklists. Described in Section 11.2.2.2. Checklists help in managing
the control quality activities in a structured manner.
Check sheets. Check sheets are also known as tally sheets and are used
to organize facts in a manner that will facilitate the effective collection
of useful data about a potential quality problem. They are especially
useful for gathering attributes data while performing inspections to
identify defects; for example, data about the frequencies or
consequences of defects collected. See Figure 8-12.
Statistical sampling. Statistical sampling involves choosing part of a
population of interest for inspection (for example, selecting 10
engineering drawings at random from a list of 75). The sample is taken
to measure controls and verify quality. Sample frequency and sizes
should be determined during the Plan Quality Management process.
Questionnaires and Surveys. Surveys may be used to gather data about
customer satisfaction after the deployment of the product or service.
The cost regarding defects identified in the surveys may be considered
external failure costs in the COQ model and can have extensive cost
implications for the organization.
8.3.2.2 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Performance reviews. Performance reviews measure, compare, and
analyze the quality metrics defined by the Plan Quality Management
process against the actual results.
Root cause analysis (RCA). Described in Section 8.2.2.2. Root cause
analysis is used to identify the source of defects.
8.3.2.3 INSPECTION
An inspection is the examination of a work product to determine if it
conforms to documented standards. The results of inspections generally include
measurements and may be conducted at any level. The results of a single activity
can be inspected, or the final product of the project can be inspected. Inspections
may be called reviews, peer reviews, audits, or walkthroughs. In some
application areas, these terms have narrow and specific meanings. Inspections
also are used to verify defect repairs.
8.3.2.4 TESTING/PRODUCT EVALUATIONS
Testing is an organized and constructed investigation conducted to provide
objective information about the quality of the product or service under test in
accordance with the project requirements. The intent of testing is to find errors,
defects, bugs, or other nonconformance problems in the product or service. The
type, amount, and extent of tests needed to evaluate each requirement are part of
the project quality plan and depend on the nature of the project, time, budget,
and other constraints. Tests can be performed throughout the project, as different
components of the project become available, and at the end of the project on the
final deliverables. Early testing helps identify nonconformance problems and
helps reduce the cost of fixing the nonconforming components.
Different application areas require different tests. For example, software
testing may include unit testing, integration testing, black-box, white-box,
interface testing, regression testing, Alpha testing, etc. In construction projects,
testing may include cement strength, concrete workability test, nondestructive
tests at construction sites for testing the quality of hardened concrete structures,
and soil tests. In hardware development, testing may include environmental
stress screening, burn-in tests, system testing, and more.
8.3.2.5 DATA REPRESENTATION
Data representation techniques that can be used for this process include but
are not limited to:
Cause-and-effect diagrams. Described in Section 8.2.2.4. Cause-and-
effect diagrams are used to identify the possible effects of quality
defects and errors.
Control charts. Control charts are used to determine whether or not a
process is stable or has predictable performance. Upper and lower
specification limits are based on the requirements and reflect the
maximum and minimum values allowed. Upper and lower control
limits are different from specification limits. The control limits are
determined using standard statistical calculations and principles to
ultimately establish the natural capability for a stable process. The
project manager and appropriate stakeholders may use the statistically
calculated control limits to identify the points at which corrective
action will be taken to prevent performance that remains outside the
control limits. Control charts can be used to monitor various types of
output variables. Although used most frequently to track repetitive
activities required for producing manufactured lots, control charts may
also be used to monitor cost and schedule variances, volume,
frequency of scope changes, or other management results to help
determine if the project management processes are in control.
Histograms. Described in Section 8.2.2.4. Histograms can demonstrate
the number of defects by source or by component.
Scatter diagrams. Described in Section 8.2.2.4. Scatter diagrams can
show the planned performance on one axis and the actual performance
on the second axis.
8.3.2.6 MEETINGS
The following meetings may be used as part of the Control Quality process:
Approved change requests review. All approved change requests
should be reviewed to verify that they were implemented as approved.
This review should also check that partial changes are completed and
all parts have been properly implemented, tested, completed, and
certified.
Retrospectives/lesson learned. A meeting held by a project team to
discuss:
Successful elements in the project/phase,
What could be improved,
What to incorporate in the ongoing project and what in future
projects, and
What to add to the organization process assets.
8.3.3 CONTROL QUALITY: OUTPUTS
8.3.3.1 QUALITY CONTROL MEASUREMENTS
Quality control measurements are the documented results of Control Quality
activities. They should be captured in the format that was specified in the quality
management plan.
8.3.3.2 VERIFIED DELIVERABLES
A goal of the Control Quality process is to determine the correctness of
deliverables. The results of performing the Control Quality process are verified
deliverables that become an input to the Validate Scope process (Section 5.5) for
formalized acceptance. If there were any change requests or improvements
related to the deliverables, they may be changed, inspected, and reverified.
8.3.3.3 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on project requirements fulfillment, causes for rejections, rework
required, recommendations for corrective actions, lists of verified deliverables,
status of the quality metrics, and the need for process adjustments.
8.3.3.4 CHANGE REQUESTS
Described in Section 4.3.3.4. If changes occur during the Control Quality
process that may impact any of the components of the project management plan
or project documents, the project manager should submit a change request.
Change requests are processed for review and disposition through the Perform
Integrated Change Control process (Section 4.6).
8.3.3.5 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to
the quality management plan, as described in Section 8.1.3.1.
8.3.3.6 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. Many times a deliverable that
does not meet the quality requirements is documented as an issue.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on the source of quality
defects and how they could have been avoided as well as approaches
that worked well.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
Test and evaluation documents. Described in Section 8.2.3.2. Test and
evaluation documents may be modified as a result of this process in
order to make future tests more effective.
9
PROJECT RESOURCE MANAGEMENT
Project Resource Management includes the processes to identify, acquire, and
manage the resources needed for the successful completion of the project. These
processes help ensure that the right resources will be available to the project
manager and project team at the right time and place.
The Project Resource Management processes are:
9.1 Plan Resource Management—The process of defining how to estimate,
acquire, manage, and utilize physical and team resources.
9.2 Estimate Activity Resources—The process of estimating team resources
and the type and quantities of material, equipment, and supplies necessary to
perform project work.
9.3 Acquire Resources—The process of obtaining team members, facilities,
equipment, materials, supplies, and other resources necessary to complete
project work.
9.4 Develop Team—The process of improving competencies, team member
interaction, and the overall team environment to enhance project performance.
9.5 Manage Team—The process of tracking team member performance,
providing feedback, resolving issues, and managing team changes to optimize
project performance.
9.6 Control Resources—The process of ensuring that the physical resources
assigned and allocated to the project are available as planned, as well as
monitoring the planned versus actual use of resources, and performing corrective
action as necessary.
Figure 9-1 provides an overview of the Project Resource Management
processes. The Project Resource Management processes are presented as discrete
processes with defined interfaces while, in practice, they overlap and interact in
ways that cannot be completely detailed in the PMBOK® Guide.
There is a distinction between the skills and competencies needed for the
project manager to manage team resources versus physical resources. Physical
resources include equipment, materials, facilities, and infrastructure. Team
resources or personnel refer to the human resources. Personnel may have varied
skill sets, may be assigned full- or part-time, and may be added or removed from
the project team as the project progresses. There is some overlap between
Project Resource Management and Project Stakeholder Management (Section
13). This section (Section 9) focuses on the subset of stakeholders who make up
the project team.
KEY CONCEPTS FOR PROJECT RESOURCE MANAGEMENT
The project team consists of individuals with assigned roles and
responsibilities who work collectively to achieve a shared project goal. The
project manager should invest suitable effort in acquiring, managing, motivating,
and empowering the project team. Although specific roles and responsibilities
for the project team members are assigned, the involvement of all team members
in project planning and decision making is beneficial. Participation of team
members during planning adds their expertise to the process and strengthens
their commitment to the project.
The project manager should be both leader and manager of the project team.
In addition to project management activities such as initiating, planning,
executing, monitoring and controlling, and closing the various project phases,
the project manager is responsible for the team formation as an effective group.
The project manager should be aware of different aspects that influence the
team, such as:
Team environment,
Geographical locations of team members,
Communications among stakeholders,
Organizational change management,
Internal and external politics,
Cultural issues and organizational uniqueness, and
Other factors that may alter project performance.
As a leader, the project manager is also responsible for proactively developing
team skills and competencies while retaining and improving team satisfaction
and motivation. The project manager should be aware of, and subscribe to,
professional and ethical behavior, and ensure that all team members adhere to
these behaviors.
Physical resource management is concentrated in allocating and using the
physical resources (material, equipment, and supplies, for example) needed for
successful completion of the project in an efficient and effective way. In order to
do that, organizations should have data on resource demands (now and in the
reasonable future), resource configurations that will be required to meet those
demands, and the supply of resources. Failing to manage and control resources
efficiently is a source of risk for successful project completion. For example:
Failing to secure critical equipment or infrastructure on time may
result in delays in the manufacturing of the final product,
Ordering low-quality material may damage the quality of the product
causing a high rate of recalls or rework, and
Keeping too much inventory may result in high operations costs and
reduce the organization's profit. Unacceptably low inventory level, on
the other hand, may result in not satisfying customer demand and,
again, reduce the organization's profit.
TRENDS AND EMERGING PRACTICES IN PROJECT RESOURCE
MANAGEMENT
Project management styles are shifting away from a command and control
structure for managing projects and toward a more collaborative and supportive
management approach that empowers teams by delegating decision making to
the team members. In addition, modern project resource management
approaches seek to optimize resource utilization. Trends and emerging practices
for Project Resource Management include but are not limited to:
Resource management methods. Due to the scarce nature of critical
resources, in some industries, several trends have become popular in
the past several years. There is extensive literature about lean
management, just-in-time (JIT) manufacturing, Kaizen, total
productive maintenance (TPM), theory of constraints (TOC), and other
methods. A project manager should determine if the performing
organization has adopted one or more resource management tools and
adapt the project accordingly.
Emotional intelligence (EI). The project manager should invest in
personal EI by improving inbound (e.g., self-management and self-
awareness) and outbound (e.g., relationship management)
competencies. Research suggests that project teams that succeed in
developing team EI or become an emotionally competent group are
more effective. Additionally, there is a reduction in staff turnover.
Self-organizing teams. The increase in using agile approaches mainly
for the execution of IT projects has given rise to the self-organizing
team, where the team functions with an absence of centralized control.
In projects that have self-organizing teams, the project manager (who
may not be called a project manager) role provides the team with the
environment and support needed and trusts the team to get the job
done. Successful self-organizing teams usually consist of generalized
specialists, instead of subject matter experts, who continuously adapt
to the changing environment and embrace constructive feedback.
Virtual teams/distributed teams. The globalization of projects has
promoted the need for virtual teams that work on the same project, but
are not colocated at the same site. The availability of communication
technology such as email, audio conferencing, social media, web-
based meetings, and video conferencing has made virtual teams
feasible. Managing virtual teams has unique advantages, such as being
able to use special expertise on a project team even when the expert is
not in the same geographic area, incorporating employees who work
from home offices, and including people with mobility limitations or
disabilities. The challenges of managing virtual teams are mainly in
the communication domain, including a possible feeling of isolation,
gaps in sharing knowledge and experience between team members,
and difficulties in tracking progress and productivity, possible time
zone difference and cultural differences.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager will need to tailor the way
Project Resource Management processes are applied. Considerations for
tailoring include but are not limited to:
Diversity. What is the diversity background of the team?
Physical location. What is the physical location of team members and
physical resources?
Industry-specific resources. What special resources are needed in the
industry?
Acquisition of team members. How will team members be acquired
for the project? Are team resources full-time or part-time on the
project?
Management of team. How is team development managed for the
project? Are there organizational tools to manage team development or
will new ones need to be established? Are there team members who
have special needs? Will the team need special training to manage
diversity?
Life cycle approaches. What life cycle approach will be used on the
project?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Projects with high variability benefit from team structures that maximize
focus and collaboration, such as self-organizing teams with generalizing
specialists.
Collaboration is intended to boost productivity and facilitate innovative
problem solving. Collaborative teams may facilitate accelerated integration of
distinct work activities, improve communication, increase knowledge sharing,
and provide flexibility of work assignments in addition to other advantages.
Although the benefits of collaboration also apply to other project
environments, collaborative teams are often critical to the success of projects
with a high degree of variability and rapid changes, because there is less time for
centralized tasking and decision making.
Planning for physical and human resources is much less predictable in
projects with high variability. In these environments, agreements for fast supply
and lean methods are critical to controlling costs and achieving the schedule.
9.1 PLAN RESOURCE MANAGEMENT
Plan Resource Management is the process of defining how to estimate,
acquire, manage, and use team and physical resources. The key benefit of this
process is that it establishes the approach and level of management effort needed
for managing project resources based on the type and complexity of the project.
This process is performed once or at predefined points in the project. The inputs,
tools and techniques, and outputs of the process are depicted in Figure 9-2.
Figure 9-3 depicts the data flow diagram for the process.
Resource planning is used to determine and identify an approach to ensure
that sufficient resources are available for the successful completion of the
project. Project resources may include team members, supplies, materials,
equipment, services and facilities. Effective resource planning should consider
and plan for the availability of, or competition for, scarce resources.
Those resources can be obtained from the organization's internal assets or
from outside the organization through a procurement process. Other projects
may be competing for the same resources required for the project at the same
time and location. This may significantly impact project costs, schedules, risks,
quality, and other project areas.
9.1.1 PLAN RESOURCE MANAGEMENT: INPUTS
9.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter provides the high-level
project description and requirements. It also has the key stakeholder list,
summary milestones, and preapproved financial resources that may influence the
resource management of the project.
9.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Quality management plan. Described in Section 8.1.3.1. The quality
management plan helps define the level of resources that will be
required to achieve and maintain the defined level of quality and
achieve the metrics for the project.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
identifies the deliverables that drive the types and quantities of
resources that will need to be managed.
9.1.1.3 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Project schedule. Described in Section 6.5.3.2. The project schedule
shows the timeline for needed resources.
Requirements documentation. Described in Section 5.2.3.1.
Requirements will dictate the type and amount of resources needed for
the project and may influence how they are managed.
Risk register. Described in Section 11.2.3.1. The risk register contains
information on threats and opportunities that may impact resource
planning.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register aids in identifying those stakeholders who have a particular
interest in or an impact on resources needed for the project. It also
helps to identify stakeholders who can influence the use of one kind of
resource over another.
9.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Resource
Management include but are not limited to:
Organizational culture and structure,
Geographic distribution of facilities and resources,
Existing resources competencies and availability, and
Marketplace conditions.
9.1.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Resource
Management include but are not limited to:
Human resource policies and procedures,
Physical resource management policies and procedures,
Safety policies,
Security policies,
Templates for the resource management plan, and
Historical information for similar projects.
9.1.2 PLAN RESOURCE MANAGEMENT: TOOLS AND
TECHNIQUES
9.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Negotiating for the best resources within the organization;
Talent management and personnel development;
Determining the preliminary effort level needed to meet project
objectives;
Determining reporting requirements based on the organizational
culture;
Estimating lead times required for acquisition, based on lessons
learned and market conditions;
Identifying risks associated with resource acquisition, retention, and
release plans;
Complying with applicable government and union regulations; and
Managing sellers and the logistics effort to ensure materials and
supplies are available when needed.
9.1.2.2 DATA REPRESENTATION
Data representation techniques that can be used for this process include but
are not limited to charts. Various formats exist to document and communicate
team member roles and responsibilities. Most fall into hierarchical, matrix, or
text-oriented formats. Some project assignments are listed in subsidiary plans,
such as the risk, quality, or communications management plans. Regardless of
the method used to document team member roles, the objective is to ensure that
each work package has an unambiguous owner and that all team members have a
clear understanding of their roles and responsibilities. A hierarchical format may
be used to represent high-level roles, while a text-based format may be better
suited to document the detailed responsibilities.
Hierarchical charts. The traditional organizational chart structure can
be used to show positions and relationships in a graphical, top-down
format.
Work breakdown structures (WBS). The WBS is designed to show
how project deliverables are broken down into work packages and
provide a way of showing high-level areas of responsibility.
Organizational breakdown structure (OBS). While the WBS shows
a breakdown of project deliverables, an OBS is arranged according to
an organization's existing departments, units, or teams, with the
project activities or work packages listed under each department. An
operational department, such as information technology or
purchasing, can see all of its project responsibilities by looking at its
portion of the OBS.
Resource breakdown structure. The resource breakdown structure is
a hierarchical list of team and physical resources related by category
and resource type that is used for planning, managing and controlling
project work. Each descending (lower) level represents an
increasingly detailed description of the resource until the information
is small enough to be used in conjunction with the work breakdown
structure (WBS) to allow the work to be planned, monitored, and
controlled.
Assignment Matrix. A RAM shows the project resources assigned to
each work package. It is used to illustrate the connections between
work packages, or activities, and project team members. On larger
projects, RAMs can be developed at various levels. For example, a
high-level RAM can define the responsibilities of a project team,
group, or unit within each component of the WBS. Lower-level RAMs
are used within the group to designate roles, responsibilities, and levels
of authority for specific activities. The matrix format shows all
activities associated with one person and all people associated with
one activity. This also ensures that there is only one person
accountable for any one task to avoid confusion about who is
ultimately in charge or has authority for the work. One example of a
RAM is a RACI (responsible, accountable, consult, and inform) chart,
shown in Figure 9-4. The sample chart shows the work to be done in
the left column as activities. The assigned resources can be shown as
individuals or groups. The project manager can select other options,
such as “lead” and “resource” designations, as appropriate for the
project. A RACI chart is a useful tool to use to ensure clear assignment
of roles and responsibilities when the team consists of internal and
external resources.
Text-oriented formats. Team member responsibilities that require
detailed descriptions can be specified in text-oriented formats. Usually
in outline form, these documents provide information such as
responsibilities, authority, competencies, and qualifications. The
documents are known by various names including position
descriptions and role-responsibility-authority forms. These documents
can be used as templates for future projects, especially when the
information is updated throughout the current project by applying
lessons learned.
9.1.2.3 ORGANIZATIONAL THEORY
Organizational theory provides information regarding the way in which
people, teams, and organizational units behave. Effective use of common
techniques identified in organizational theory can shorten the amount of time,
cost, and effort needed to create the Plan Resource Management process outputs
and improve planning efficiency. Applicable organizational theories may
recommend exercising a flexible leadership style that adapts to the changes in a
team's maturity level throughout the project life cycle. It is important to
recognize that the organization's structure and culture impacts the project
organizational structure.
9.1.2.4 MEETINGS
The project team may hold meetings to plan resource management for the
project.
9.1.3 PLAN RESOURCE MANAGEMENT: OUTPUTS
9.1.3.1 RESOURCE MANAGEMENT PLAN
The resource management plan is the component of the project management
plan that provides guidance on how project resources should be categorized,
allocated, managed, and released. It may be divided between the team
management plan and physical resource management plan according to the
specifics of the project. The resource management plan may include but is not
limited to:
Identification of resources. Methods for identifying and quantifying
team and physical resources needed.
Acquiring resources. Guidance on how to acquire team and physical
resources for the project.
Roles and responsibilities:
Role. The function assumed by, or assigned to, a person in the
project. Examples of project roles are civil engineer, business analyst,
and testing coordinator.
Authority. The rights to apply project resources, make decisions, sign
approvals, accept deliverables, and influence others to carry out the
work of the project. Examples of decisions that need clear authority
include the selection of a method for completing an activity, quality
acceptance criteria, and how to respond to project variances. Team
members operate best when their individual levels of authority match
their individual responsibilities.
Responsibility. The assigned duties and work that a project team
member is expected to perform in order to complete the project's
activities.
Competence. The skill and capacity required to complete assigned
activities within the project constraints. If project team members do
not possess required competencies, performance can be jeopardized.
When such mismatches are identified, proactive responses such as
training, hiring, schedule changes, or scope changes are initiated.
Project organization charts. A project organization chart is a graphic
display of project team members and their reporting relationships. It
can be formal or informal, highly detailed or broadly framed, based on
the needs of the project. For example, the project organization chart
for a 3,000-person disaster response team will have greater detail than
a project organization chart for an internal, 20-person project.
Project team resource management. Guidance on how project team
resources should be defined, staffed, managed, and eventually
released.
Training. Training strategies for team members.
Team development. Methods for developing the project team.
Resource control. Methods for ensuring adequate physical resources
are available as needed and that the acquisition of physical resources is
optimized for project needs. Includes information on managing
inventory, equipment, and supplies during throughout the project life
cycle.
Recognition plan. Which recognition and rewards will be given to
team members, and when they will be given.
9.1.3.2 TEAM CHARTER
The team charter is a document that establishes the team values, agreements,
and operating guidelines for the team. The team charter may include but is not
limited to:
Team values,
Communication guidelines,
Decision-making criteria and process,
Conflict resolution process,
Meeting guidelines, and
Team agreements.
The team charter establishes clear expectations regarding acceptable behavior
by project team members. Early commitment to clear guidelines decreases
misunderstandings and increases productivity. Discussing areas such as codes of
conduct, communication, decision making, and meeting etiquette allows team
members to discover values that are important to one another. The team charter
works best when the team develops it, or at least has an opportunity to contribute
to it. All project team members share responsibility for ensuring the rules
documented in the team charter are followed. The team charter can be reviewed
and updated periodically to ensure a continued understanding of the team ground
rules and to orient and integrate new team members.
9.1.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log is
updated with assumptions regarding the availability, logistics
requirements, and location of physical resources as well as the skill
sets and availability of team resources.
Risk register. Described in Section 11.2.3.1. The risk register is
updated with risks associated with team and physical resource
availability or other known resource-related risks.
9.2 ESTIMATE ACTIVITY RESOURCES
Estimate Activity Resources is the process of estimating team resources and
the type and quantities of materials, equipment, and supplies necessary to
perform project work. The key benefit of this process is that it identifies the type,
quantity, and characteristics of resources required to complete the project. This
process is performed periodically throughout the project as needed. The inputs,
tools and techniques, and outputs of this process are depicted in Figure 9-5.
Figure 9-6 depicts the data flow diagram of the process.
The Estimate Activity Resources process is closely coordinated with other
processes, such as the Estimate Costs process. For example:
A construction project team will need to be familiar with local
building codes. Such knowledge is often readily available from local
sellers. If the internal labor pool lacks experience with unusual or
specialized construction techniques, the additional cost for a consultant
may be the most effective way to secure knowledge of the local
building codes.
An automotive design team will need to be familiar with the latest
automated assembly techniques. The requisite knowledge could be
obtained by hiring a consultant, by sending a designer to a seminar on
robotics, or by including someone from manufacturing as a member of
the project team.
9.2.1 ESTIMATE ACTIVITY RESOURCES: INPUTS
9.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan defines the approach to identify the
different resources needed for the project. It also defines the methods
to quantify the resources needed for each activity and aggregates this
information.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
identifies the project and product scope necessary to meet the project
objectives. The scope drives the needs for both team and physical
resources.
9.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Activity attributes. Described in Section 6.2.3.2. Activity attributes
provide the primary data source for use in estimating team and
physical resources required for each activity on the activity list.
Examples of attributes include the resource requirements, imposed
dates, activity location, assumptions, and constraints.
Activity list. Described in Section 6.2.3.1. The activity list identifies
the activities that will need resources.
Assumption log. Described in Section 4.1.3.2. The assumption log
may have information on productivity factors, availability, cost
estimates, and approaches to work that will influence the nature and
number of team and physical resources.
Cost estimates. Described in Section 7.2.3.1. The cost of resources
may impact resource selection from the quantity and skill level
perspectives.
Resource calendars. A resource calendar identifies the working days,
shifts, start and end of normal business hours, weekends, and public
holidays when each specific resource is available. Information on
which resources (such as team resource, equipment, and material) are
potentially available during a planned activity period is used for
estimating resource utilization. Resource calendars also specify when,
and for how long, identified team and physical resources will be
available during the project. This information may be at the activity or
project level. This includes consideration of attributes such as resource
experience and/or skill level, as well as various geographical locations.
Risk register. Described in Section 11.2.3.1. The risk register describes
the individual risks that can impact resource selection and availability.
9.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Estimate Activity
Resources process include but are not limited to:
Resource location,
Resource availability,
Team resource skills,
Organizational culture,
Published estimating data, and
Marketplace conditions.
9.2.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Estimate Activity
Resources process include but are not limited to:
Policies and procedures regarding staffing,
Policies and procedures relating to supplies and equipment, and
Historical information regarding types of resources used for similar
work on previous projects.
9.2.2 ESTIMATE ACTIVITY RESOURCES: TOOLS AND
TECHNIQUES
9.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in team and physical resource
planning and estimating.
9.2.2.2 BOTTOM-UP ESTIMATING
Described in Section 6.4.2.5. Team and physical resources are estimated at the
activity level and then aggregated to develop the estimates for work packages,
control accounts, and summary project levels.
9.2.2.3 ANALOGOUS ESTIMATING
Described in Section 6.4.2.2. Analogous estimating uses information
regarding resources from a previous similar project as the basis for estimating a
future project. It is used as quick estimating method and can be used when the
project manager can only identify a few top levels of the WBS.
9.2.2.4 PARAMETRIC ESTIMATING
Described in Section 6.4.2.3. Parametric estimating uses an algorithm or a
statistical relationship between historical data and other variables to calculate
resource quantities needed for an activity, based on historical data and project
parameters. For example, if an activity needs 4,000 hours of coding and it needs
to finish it in 1 year, it will require two people to code (each doing 2,000 hours a
year). This technique can produce higher levels of accuracy depending on the
sophistication and underlying data built into the model.
9.2.2.5 DATA ANALYSIS
A data analysis technique used in this process includes but is not limited to
alternatives analysis. Alternatives analysis is used to evaluate identified options
in order to select the options or approaches to use to execute and perform the
work of the project. Many activities have multiple options for accomplishment.
They include using various levels of resource capability or skills, different sizes
or types of machines, different tools (manual versus automated), and make-rent-
or-buy decisions regarding the resources. Alternatives analysis assists in
providing the best solution to perform the project activities, within the defined
constraints.
9.2.2.6 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems can
include resource management software that can help plan, organize, and manage
resource pools and develop resource estimates. Depending on the sophistication
of the software, resource breakdown structures, resource availability, resource
rates, and various resource calendars can be defined to assist in optimizing
resource utilization.
9.2.2.7 MEETINGS
The project manager may hold planning meetings with functional managers to
estimate the resources needed per activity, level of effort (LoE), skill level of the
team resources, and the quantity of the materials needed. Participants at these
meetings may include the project manager, the project sponsor, selected project
team members, selected stakeholders, and others as needed.
9.2.3 ESTIMATE ACTIVITY RESOURCES: OUTPUTS
9.2.3.1 RESOURCE REQUIREMENTS
Resource requirements identify the types and quantities of resources required
for each work package or activity in a work package and can be aggregated to
determine the estimated resources for each work package, each WBS branch,
and the project as a whole. The amount of detail and the level of specificity of
the resource requirement descriptions can vary by application area. The resource
requirements’ documentation can include assumptions that were made in
determining which types of resources are applied, their availability, and what
quantities are needed.
9.2.3.2 BASIS OF ESTIMATES
Described in Section 6.4.3.2. The amount and type of additional details
supporting the resource estimate vary by application area. Regardless of the level
of detail, the supporting documentation should provide a clear and complete
understanding of how the resource estimate was derived.
Supporting detail for resource estimates may include:
Method used to develop the estimate,
Resources used to develop the estimate (such as information from
previous similar projects),
Assumptions associated with the estimate,
Known constraints,
Range of estimates,
Confidence level of the estimate, and
Documentation of identified risks influencing the estimate.
9.2.3.3 RESOURCE BREAKDOWN STRUCTURE
The resource breakdown structure is a hierarchical representation of resources
by category and type (see Figure 9-7 for example). Examples of resource
categories include but are not limited to labor, material, equipment, and supplies.
Resource types may include the skill level, grade level, required certifications, or
other information as appropriate to the project. In Plan Resource Management,
the resource breakdown structure was used to guide the categorization for the
project. In this process it is a completed document that will be used to acquire
and monitor resources.
9.2.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Activity attributes. Described in Section 6.2.3.2. The activity attributes
are updated with the resource requirements.
Assumption log. Described in Section 4.1.3.2. The assumption log is
updated with assumptions regarding the types and quantities of
resources required. Additionally, any resource constraints are entered
including collective bargaining agreements, continuous hours of
operation, planned leave, etc.
Lessons learned register. Described in Section 11.2.3.1. The lessons
learned register can be updated with techniques that were efficient and
effective in developing resource estimates, and information on those
techniques that were not efficient or effective.
9.3 ACQUIRE RESOURCES
Acquire Resources is the process of obtaining team members, facilities,
equipment, materials, supplies, and other resources necessary to complete
project work. The key benefit of this process is that it outlines and guides the
selection of resources and assigns them to their respective activities. This
process is performed periodically throughout the project as needed. The inputs,
tools and techniques, and outputs of the process are depicted in Figure 9-8.
Figure 9-9 depicts the data flow diagram for the process.
The resources needed for the project can be internal or external to the project-
performing organization. Internal resources are acquired (assigned) from
functional or resource managers. External resources are acquired through the
procurement processes.
The project management team may or may not have direct control over
resource selection because of collective bargaining agreements, use of
subcontractor personnel, a matrix project environment, internal or external
reporting relationships, or other reasons. It is important that the following factors
are considered during the process of acquiring the project resources:
The project manager or project team should effectively negotiate and
influence others who are in a position to provide the required team and
physical resources for the project.
Failure to acquire the necessary resources for the project may affect
project schedules, budgets, customer satisfaction, quality, and risks.
Insufficient resources or capabilities decrease the probability of
success and, in a worst-case scenario, could result in project
cancellation.
If the team resources are not available due to constraints such as
economic factors or assignment to other projects, the project manager
or project team may be required to assign alternative resources,
perhaps with different competencies or costs. Alternative resources are
allowed provided there is no violation of legal, regulatory, mandatory,
or other specific criteria.
These factors should be considered and accounted for in the planning stages of
the project. The project manager or project management team will be required to
document the impact of the unavailability of required resources in the project
schedule, project budget, project risks, project quality, training plans, and other
project management plans.
9.3.1 ACQUIRE RESOURCES: INPUTS
9.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan provides guidance on how to acquire
resources for the project.
Procurement management plan. Described in Section 12.1.3.1. The
procurement management plan has information regarding resources
that will be acquired from outside the project. This includes
information on how procurements will be integrated with other project
work and stakeholders involved in procuring resources.
Cost baseline. Described in Section 7.3.3.1. The cost baseline provides
the overall budget for the project activities.
9.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Project schedule. Described in Section 6.5.3.2. The project schedule
shows the activities and their planned start and end dates to help
determine when the resources need to be available and acquired.
Resource calendars. Described in Section 9.3.3.3. Resource calendars
document the time periods that each resource needed for the project is
available for the project. Creating a reliable schedule depends on
having a good understanding of each resource's availability and
schedule constraints, including time zones, work hours, vacation time,
local holidays, maintenance schedule and commitments to other
projects. Resource calendars are progressively elaborated and updated
throughout the project. Once created as an output of this process, they
are used as needed whenever this process is repeated.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements identify which resources need to be acquired.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register may reveal stakeholders’ needs or expectations for specific
resources to be used on the project that need to be considered in the
Acquire Resources process.
9.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Acquire Resources
process include but are not limited to:
Existing information on organizational resources including
availability, competence levels, and prior experience for team
resources and resource costs;
Marketplace conditions;
Organizational structure; and
Geographic locations.
9.3.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Acquire Resources
process include but are not limited to:
Policies and procedures for acquiring, allocating, and assigning
resources to the project; and
Historical information and lessons learned repository.
9.3.2 ACQUIRE RESOURCES: TOOLS AND TECHNIQUES
9.3.2.1 DECISION MAKING
Described in Section 5.2.2.4. Decision-making techniques that can be used in
the Acquire Resources process include but are not limited to multicriteria
decision analysis, as described in Section 8.1.2.4. Selection criteria are often
used to select physical project resources, or the project team. Using a
multicriteria decision analysis tool, criteria are developed and used to rate or
score potential resources (for example, choosing between internal and external
team resources). The criteria are weighted according to their relative importance
and values can be changed for different types of resources. Some examples of
selection criteria that can be used are:
Availability. Verify that the resource is available to work on the
project within the time period needed.
Cost. Verify if the cost of adding the resource is within the prescribed
budget.
Ability. Verify that the team member provides the capability needed
by the project.
Some selection criteria that are unique for team resources are:
Experience. Verify that the team member has the relevant experience
that will contribute to the project success.
Knowledge. Consider if the team member has relevant knowledge of
the customer, similar implemented projects, and nuances of the project
environment.
Skills. Determine if the team member has the relevant skills to use a
project tool.
Attitude. Determine if the team member has the ability to work with
others as a cohesive team.
International factors. Consider team member location, time zone, and
communication capabilities.
9.3.2.2 INTERPERSONAL AND TEAM SKILLS
An interpersonal and team skill that can be used for this process includes but
is not limited to negotiation. Described in Section 12.2.2.5. Many projects need
to negotiate for required resources. The project management team may need to
negotiate with:
Functional managers. Ensure that the project receives the best
resources possible in the required timeframe and until their
responsibilities are complete.
Other project management teams within the performing organization.
Appropriately assign or share scarce or specialized resources.
External organizations and suppliers. Provide appropriate, scarce,
specialized, qualified, certified, or other specific team or physical
resources. Special consideration should be given to external
negotiating policies, practices, processes, guidelines, legal, and other
such criteria.
The project management team's ability to influence others plays an important
role in negotiating resource allocation, as does the politics of the organizations
involved. For example, convincing a functional manager about the high visibility
of the project may influence him or her to assign the best resources to this
project over competing ones.
9.3.2.3 PRE-ASSIGNMENT
When physical or team resources for a project are determined in advance, they
are considered pre-assigned. This situation can occur if the project is the result of
specific resources being identified as part of a competitive proposal or if the
project is dependent upon the expertise of particular persons. Pre-assignment
might also include the team members who have already been assigned in
Develop Project Charter Process or other processes before the initial Resource
Management Plan has been completed.
9.3.2.4 VIRTUAL TEAMS
The use of virtual teams creates new possibilities when acquiring project team
members. Virtual teams can be defined as groups of people with a shared goal
who fulfill their roles with little or no time spent meeting face to face. The
availability of communication technology such as email, audio conferencing,
social media, web-based meetings, and video conferencing has made virtual
teams feasible. The virtual team model makes it possible to:
Form teams of people from the same organization who live in
widespread geographic areas;
Add special expertise to a project team even though the expert is not in
the same geographic area;
Incorporate employees who work from home offices;
Form teams of people who work different shifts, hours, or days;
Include people with mobility limitations or disabilities;
Move forward with projects that would have been held or canceled due
to travel expenses; and
Save the expense of offices and all physical equipment needed for
employees.
Communication planning becomes increasingly important in a virtual team
environment. Additional time may be needed to set clear expectations, facilitate
communications, develop protocols for resolving conflict, include people in
decision making, understand cultural differences, and share credit in successes.
9.3.3 ACQUIRE RESOURCES: OUTPUTS
9.3.3.1 PHYSICAL RESOURCE ASSIGNMENTS
Documentation of the physical resource assignments records the material,
equipment, supplies, locations, and other physical resources that will be used
during the project.
9.3.3.2 PROJECT TEAM ASSIGNMENTS
Documentation of team assignments records the team members and their roles
and responsibilities for the project. Documentation can include a project team
directory and names inserted into the project management plan, such as the
project organization charts and schedules.
9.3.3.3 RESOURCE CALENDARS
A resource calendar identifies the working days, shifts, start and end of
normal business hours, weekends, and public holidays when each specific
resource is available. Information on which resources (such as team resource,
equipment, and material) are potentially available during a planned activity
period is used for estimating resource utilization. Resource calendars also
specify when and for how long identified team and physical resources will be
available during the project. This information may be at the activity or project
level. This includes consideration of attributes such as resource experience
and/or skill level, as well as various geographical locations.
9.3.3.4 CHANGE REQUESTS
Described in Section 4.3.3.4. When changes occur as a result of carrying out
the Acquire Resources process (for example, impacts to the schedule) or when
recommended corrective or preventive actions impact any of the components of
the project management plan or project documents, the project manager needs to
submit a change request. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
9.3.3.5 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may be updated as a result of carrying out this process
include but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan may be updated to reflect actual experience
in acquiring resources for the project, including lessons learned in
acquiring resources early in the project that will impact how resources
are acquired later in the project.
Cost baseline. Described in Section 7.3.3.1. The cost baseline may
change as a result of the acquisition of resources for the project.
9.3.3.6 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well for acquiring resources.
Project schedule. Described in Section 6.5.3.2. Changes to the project
schedule may result from the availability of required resources.
Resource breakdown structure. Described in Section 9.2.3.3.
Resources acquired during this process are recorded in the resource
breakdown structure.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements documentation is updated to reflect resources acquired
for the project.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register is updated with any new stakeholders and any new information
about existing stakeholders that has been gained as a result of this
process.
9.3.3.7 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES
Enterprise environmental factors that are updated include but are not limited
to:
Resource availability within the organization, and
Amount of the organization's consumable resources that have been
used.
9.3.3.8 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that are updated as a result of the Acquire
Resources process include but are not limited to documentation related to
acquiring, assigning and allocating resources.
9.4 DEVELOP TEAM
Develop Team is the process of improving competencies, team member
interaction, and the overall team environment to enhance project performance.
The key benefit of this process is that it results in improved teamwork, enhanced
interpersonal skills and competencies, motivated employees, reduced attrition,
and improved overall project performance. This process is performed throughout
the project.
The inputs, tools and techniques, and outputs of the process are depicted in
Figure 9-10. Figure 9-11 depicts the data flow diagram for the process.
Project managers require the skills to identify, build, maintain, motivate, lead,
and inspire project teams to achieve high team performance and to meet the
project's objectives. Teamwork is a critical factor for project success, and
developing effective project teams is one of the primary responsibilities of the
project manager. Project managers should create an environment that facilitates
teamwork and continually motivates the team by providing challenges and
opportunities, providing timely feedback and support as needed, and recognizing
and rewarding good performance. High team performance can be achieved by
employing these behaviors:
Using open and effective communication,
Creating team-building opportunities,
Developing trust among team members,
Managing conflicts in a constructive manner,
Encouraging collaborative problem solving, and
Encouraging collaborative decision making.
Project managers operate in a global environment and work on projects
characterized by cultural diversity. Team members often have diverse industry
experience, communicate in multiple languages, and sometimes work with a
“team language” or cultural norm that may be different from their native one.
The project management team should capitalize on cultural differences, focus on
developing and sustaining the project team throughout the project life cycle, and
promote working together interdependently in a climate of mutual trust.
Developing the project team improves the people skills, technical competencies,
and overall team environment and project performance. It requires clear, timely,
effective, and efficient communication between team members throughout the
life of the project. Objectives of developing a project team include but are not
limited to:
Improving the knowledge and skills of team members to increase their
ability to complete project deliverables, while lowering costs, reducing
schedules, and improving quality;
Improving feelings of trust and agreement among team members to
raise morale, lower conflict, and increase teamwork;
Creating a dynamic, cohesive, and collaborative team culture to: (1)
improve individual and team productivity, team spirit, and
cooperation; and (2) allow cross-training and mentoring between team
members to share knowledge and expertise; and
Empowering the team to participate in decision making and take
ownership of the provided solutions to improve team productivity for
more effective and efficient results.
One of the models used to describe team development is the Tuckman ladder
[19, 20], which includes five stages of development that teams may go through.
Although it is common for these stages to occur in order, it is not uncommon for
a team to get stuck in a particular stage or regress to an earlier stage. Projects
with team members who worked together in the past might skip a stage.
Forming. This phase is where the team members meet and learn about
the project and their formal roles and responsibilities. Team members
tend to be independent and not as open in this phase.
Storming. During this phase, the team begins to address the project
work, technical decisions, and the project management approach. If
team members are not collaborative or open to differing ideas and
perspectives, the environment can become counterproductive.
Norming. In this phase, team members begin to work together and
adjust their work habits and behaviors to support the team. The team
members learn to trust each other.
Performing. Teams that reach the performing stage function as a well-
organized unit. They are interdependent and work through issues
smoothly and effectively.
Adjourning. In this phase, the team completes the work and moves on
from the project. This typically occurs when staff is released from the
project as deliverables are completed or as part of the Close Project or
Phase process.
The duration of a particular stage depends upon team dynamics, team size,
and team leadership. Project managers should have a good understanding of
team dynamics in order to move their team members through all stages in an
effective manner.
9.4.1 DEVELOP TEAM: INPUTS
9.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the resource management plan. Described in Section
9.1.3.1, the resource management plan provides guidance on providing project
team member rewards, feedback, additional training, and disciplinary actions as
a result of team performance assessments and other forms of project team
management. The resource management plan may include also the team
performance assessment criteria.
9.4.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to developing the team can be applied
to later phases in the project to improve team performance.
Project schedule. Described in Section 6.5.3.2. The project schedule
defines how and when to provide training to the project team and
develop the competencies required at different phases. It identifies the
need for team development strategies based on variations, if any,
during the project execution.
Project team assignments. Described in Section 9.3.3.1. Project team
assignments identify the team and member roles and responsibilities.
Resource calendars. Described in Section 9.2.1.2. Resource calendars
identify times when the project team members can participate in team
development activities. It also helps illustrate team availability during
the entire project.
Team charter. Described in Section 9.1.3.2. The team charter is where
the team operating guidelines are documented. The team values and
operating guidelines provide the structure that describes how the team
will operate together.
9.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Develop Team
process include but are not limited to:
Human resource management policies regarding hiring and
termination, employee performance reviews, employee development
and training records, and recognition and rewards;
Team member skills, competencies, and specialized knowledge; and
Geographic distribution of team members.
9.4.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Develop Team
process include but are not limited to historical information and the lessons
learned repository.
9.4.2 DEVELOP TEAM: TOOLS AND TECHNIQUES
9.4.2.1 COLOCATION
Colocation involves placing many or all of the most active project team
members in the same physical location to enhance their ability to perform as a
team. Colocation can be temporary, such as at strategically important times
during the project, or can continue for the entire project. Colocation strategies
can include a team meeting room, common places to post schedules, and other
conveniences that enhance communication and a sense of community.
9.4.2.2 VIRTUAL TEAMS
The use of virtual teams can bring benefits such as the use of more skilled
resources, reduced costs, less travel and relocation expenses, and the proximity
of team members to suppliers, customers, or other key stakeholders. Virtual
teams can use technology to create an online team environment where the team
can store files, use conversations threads to discuss issues, and keep a team
calendar.
9.4.2.3 COMMUNICATION TECHNOLOGY
Described in Section 10.1.2.3. Communication technology is important in
addressing the team development issues in colocated and virtual teams. It helps
build a harmonious environment for the colocated team and a better
understanding for the virtual team, especially those working in different time
zones. Examples of communication technology that may be used are:
Shared portal. A shared repository for information sharing (e.g.,
website, collaboration software or intranet) is effective for virtual
project teams.
Video conferencing. Video conferencing is an important technique for
effective communication with virtual teams.
Audio conferencing. Communication within a team using audio
conferencing is another technique to build rapport and confidence
within virtual teams.
Email/chat. Regular communications using email and chat is also an
effective technique.
9.4.2.4 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Conflict management. Described in Section 9.5.2.1. The project
manager needs to resolve conflicts in a timely manner and in a
constructive way in order to achieve a high-performing team.
Influencing. Described in Section 9.5.2.1. An influencing skill used in
this process is gathering relevant and critical information to address
important issues and reach agreements while maintaining mutual trust.
Motivation. Motivation is providing a reason for someone to act.
Teams are motivated by empowering them to participate in decision
making and encouraging them to work independently.
Negotiation. Described in Section 12.2.2.5. Negotiation among team
members is used to reach consensus on project needs. Negotiation can
build trust and harmony among the team members.
Team building. Team building is conducting activities that enhance the
team's social relations and build a collaborative and cooperative
working environment. Team building activities can vary from a 5-
minute agenda item in a status review meeting to an offsite,
professionally facilitated event designed to improve interpersonal
relationships. The objective of team-building activities is to help
individual team members work together effectively. Team-building
strategies are particularly valuable when team members operate from
remote locations without the benefit of face-to-face contact. Informal
communication and activities can help in building trust and
establishing good working relationships. While team building is
essential during the initial stages of a project, it should be a continuous
process. Changes in a project environment are inevitable, and to
manage them effectively, a continuous or renewed team-building
effort may be applied. The project manager should continually monitor
team functionality and performance to determine if any actions are
needed to prevent or correct various team problems.
9.4.2.5 RECOGNITION AND REWARDS
Part of the team development process involves recognizing and rewarding
desirable behavior. The original plan for rewarding people is developed during
the Plan Resource Management process. Rewards will be effective only if they
satisfy a need that is valued by that individual. Reward decisions are made,
formally or informally, during the process of managing the project team.
Cultural differences should be considered when determining recognition and
rewards.
People are motivated when they feel they are valued in the organization and
this value is demonstrated by the rewards given to them. Generally, money is
viewed as a tangible aspect of any reward system, but intangible rewards could
be equally or even more effective. Most project team members are motivated by
an opportunity to grow, accomplish, be appreciated, and apply their professional
skills to meet new challenges. A good strategy for project managers is to give
the team recognition throughout the life cycle of the project rather than waiting
until the project is completed.
9.4.2.6 TRAINING
Training includes all activities designed to enhance the competencies of the
project team members. Training can be formal or informal. Examples of training
methods include classroom, online, computer-based, on-the-job training from
another project team member, mentoring, and coaching. If project team members
lack the necessary management or technical skills, such skills can be developed
as part of the project work. Scheduled training takes place as stated in the
resource management plan. Unplanned training takes place as a result of
observation, conversation, and project performance appraisals conducted during
management of the project team. Training costs could be included in the project
budget or supported by the performing organization if the added skills may be
useful for future projects. It may be performed by in-house or by external
trainers.
9.4.2.7 INDIVIDUAL AND TEAM ASSESSMENTS
Individual and team assessment tools give the project manager and the project
team insight into areas of strengths and weaknesses. These tools help project
managers assess team members’ preferences, aspirations, how they process and
organize information, how they make decisions, and how they interact with
people. Various tools are available such as attitudinal surveys, specific
assessments, structured interviews, ability tests, and focus groups. These tools
can provide improved understanding, trust, commitment, and communications
among team members and facilitate more productive teams throughout the
project.
9.4.2.8 MEETINGS
Meetings are used to discuss and address pertinent topics for developing the
team. Attendees include the project manager and the project team. Types of
meetings include but are not limited to project orientation meetings, team-
building meetings, and team development meetings.
9.4.3 DEVELOP TEAM: OUTPUTS
9.4.3.1 TEAM PERFORMANCE ASSESSMENTS
As project team development efforts such as training, team building, and
colocation are implemented, the project management team makes formal or
informal assessments of the project team's effectiveness. Effective team
development strategies and activities are expected to increase the team's
performance, which increases the likelihood of meeting project objectives.
The evaluation of a team's effectiveness may include indicators such as:
Improvements in skills that allow individuals to perform assignments
more effectively,
Improvements in competencies that help team members perform better
as a team,
Reduced staff turnover rate, and
Increased team cohesiveness where team members share information
and experiences openly and help each other to improve the overall
project performance.
As a result of conducting an evaluation of the team's overall performance, the
project management team can identify the specific training, coaching, mentoring,
assistance, or changes required to improve the team's performance. This should
also include identifying the appropriate or required resources necessary to
achieve and implement the improvements identified in the assessment.
9.4.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. If change requests occur as a result of carrying
out the Develop Team process or if recommended corrective or preventive
actions impact any of the components of the project management plan or project
documents, the project manager needs to submit a change request and follow the
Perform Integrated Change Control process as defined in Section 4.6.
9.4.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to
the resource management plan, as described in Section 9.1.3.1.
9.4.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well for the development of the team.
Project schedule. Described in Section 6.5.3.2. Activities to develop
the project team may result in changes to the project schedule.
Project team assignments. Described in Section 9.3.3.1. When team
development results in changes to agreed-upon assignments, these
changes are recorded in the project team assignments documentation.
Resource calendars. Described in Section 9.2.1.2. Resource calendars
are updated to reflect the availability of resources for the project.
Team charter. Described in Section 9.1.3.2. The team charter may be
updated to reflect changes to agreed-upon team operating guidelines
that result from team development.
9.4.3.5 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES
Enterprise environmental factors that are updated as a result of the Develop
Project Team process include but are not limited to:
Employee development plan records, and
Skill assessments.
9.4.3.6 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that are updated as a result of the Develop Team
process include but are not limited to:
Training requirements, and
Personnel assessment.
9.5 MANAGE TEAM
Manage Team is the process of tracking team member performance, providing
feedback, resolving issues, and managing team changes to optimize project
performance. The key benefit of this process is that it influences team behavior,
manages conflict, and resolves issues. This process is performed throughout the
project.
The inputs, tools and techniques, and outputs of the process are depicted in
Figure 9-12. Figure 9-13 depicts the data flow diagram for the process.
Managing the project team requires a variety of management and leadership
skills for fostering teamwork and integrating the efforts of team members to
create high-performance teams. Team management involves a combination of
skills with special emphasis on communication, conflict management,
negotiation, and leadership. Project managers should provide challenging
assignments to team members and provide recognition for high performance.
The project manager needs to be sensitive to both the willingness and the
ability of team members to perform their work and adjust their management and
leadership styles accordingly. Team members with low-skill abilities will require
more intensive oversight than those who have demonstrated ability and
experience.
9.5.1 MANAGE TEAM: INPUTS
9.5.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the resource management plan. Described in Section
9.1.3.1, the resource management plan provides guidance on how project team
resources should be managed and eventually released.
9.5.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Issue log. Described in Section 4.3.3.3. Issues arise in the course of
managing the project team. An issue log can be used to document and
monitor who is responsible for resolving specific issues by a target
date.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve the efficiency and effectiveness of managing the team.
Project team assignments. Described in Section 9.3.3.1. Project team
assignments identify the team member roles and responsibilities.
Team charter. Described in Section 9.1.3.2. The team charter provides
guidance for how the team will make decisions, conduct meetings, and
resolve conflict.
9.5.1.3 WORK PERFORMANCE REPORTS
Described in Section 4.5.3.1. Work performance reports are the physical or
electronic representation of work performance information intended to generate
decisions, actions, or awareness. Performance reports that can help with project
team management include results from schedule control, cost control, quality
control, and scope validation. The information from performance reports and
related forecasts assists in determining future team resource requirements,
recognition and rewards, and updates to the resource management plan.
9.5.1.4 TEAM PERFORMANCE ASSESSMENTS
Described in Section 9.4.3.1. The project management team makes ongoing
formal or informal assessments of the project team's performance. By
continually assessing the project team's performance, actions can be taken to
resolve issues, modify communication, address conflict, and improve team
interaction.
9.5.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Manage Team
process include but are not limited to human resource management policies.
9.5.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Manage Team process
include but are not limited to:
Certificates of appreciation,
Corporate apparel, and
Other organizational perquisites.
9.5.2 MANAGE TEAM: TOOLS AND TECHNIQUES
9.5.2.1 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Conflict management. Conflict is inevitable in a project environment.
Sources of conflict include scarce resources, scheduling priorities, and
personal work styles. Team ground rules, group norms, and solid
project management practices, like communication planning and role
definition, reduce the amount of conflict.
Successful conflict management results in greater productivity and positive
working relationships. When managed properly, differences of opinion can
lead to increased creativity and better decision making. If the differences
become a negative factor, project team members are initially responsible for
their resolution. If conflict escalates, the project manager should help
facilitate a satisfactory resolution. Conflict should be addressed early and
usually in private, using a direct, collaborative approach. If disruptive
conflict continues, formal procedures may be used, including disciplinary
actions.
The success of project managers in managing their project teams often
depends on their ability to resolve conflict. Different project managers may
use different conflict resolution methods. Factors that influence conflict
resolution methods include:
Importance and intensity of the conflict,
Time pressure for resolving the conflict,
Relative power of the people involved in the conflict,
Importance of maintaining a good relationship, and
Motivation to resolve conflict on a long-term or short-term basis.
There are five general techniques for resolving conflict. Each technique
has its place and use:
Withdraw/avoid. Retreating from an actual or potential conflict
situation; postponing the issue to be better prepared or to be
resolved by others.
Smooth/accommodate. Emphasizing areas of agreement rather
than areas of difference; conceding one's position to the needs of
others to maintain harmony and relationships.
Compromise/reconcile. Searching for solutions that bring some
degree of satisfaction to all parties in order to temporarily or
partially resolve the conflict. This approach occasionally results
in a lose-lose situation.
Force/direct. Pushing one's viewpoint at the expense of others;
offering only win-lose solutions, usually enforced through a
power position to resolve an emergency. This approach often
results to a win-lose situation.
Collaborate/problem solve. Incorporating multiple viewpoints
and insights from differing perspectives; requires a cooperative
attitude and open dialogue that typically leads to consensus and
commitment. This approach can result in a win-win situation.
Decision making. Decision making, in this context, involves the ability
to negotiate and influence the organization and the project
management team, rather than the set of tools described in the decision
making tool set. Some guidelines for decision making include:
Focus on goals to be served,
Follow a decision-making process,
Study the environmental factors,
Analyze available information,
Stimulate team creativity, and
Account for risk.
Emotional intelligence. Emotional intelligence is the ability to identify,
assess, and manage the personal emotions of oneself and other people,
as well as the collective emotions of groups of people. The team can
use emotional intelligence to reduce tension and increase cooperation
by identifying, assessing, and controlling the sentiments of project
team members, anticipating their actions, acknowledging their
concerns, and following up on their issues.
Influencing. Because project managers often have little or no direct
authority over team members in a matrix environment, their ability to
influence stakeholders on a timely basis is critical to project success.
Key influencing skills include:
Ability to be persuasive;
Clearly articulating points and positions;
High levels of active and effective listening skills;
Awareness of, and consideration for, the various perspectives in any
situation; and
Gathering relevant information to address issues and reach
agreements while maintaining mutual trust.
Leadership. Successful projects require leaders with strong leadership
skills. Leadership is the ability to lead a team and inspire them to do
their jobs well. It encompasses a wide range of skills, abilities and
actions. Leadership is important through all phases of the project life
cycle. There are multiple leadership theories defining leadership styles
that should be used as needed for each situation or team. It is
especially important to communicate the vision and inspire the project
team to achieve high performance.
9.5.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems can
include resource management or scheduling software that can be used for
managing and coordinating team members across project activities.
9.5.3 MANAGE TEAM: OUTPUTS
9.5.3.1 CHANGE REQUESTS
Described in Section 4.3.3.4. When change requests occur as a result of
carrying out the Manage Team process or when recommended corrective or
preventive actions impact any of the components of the project management
plan or project documents, the project manager needs to submit a change
request. Change requests are processed for review and disposition through the
Perform Integrated Change Control process (Section 4.6).
For example, staffing changes, whether made by choice or by uncontrollable
events, can disrupt the project team. This disruption can cause the schedule to
slip or the budget to be exceeded. Staffing changes include moving people to
different assignments, outsourcing some of the work, or replacing team members
who leave.
9.5.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may require a change request for the project management
plan include but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan is updated to reflect actual experience in
managing the project team.
Schedule baseline. Described in Section 6.5.3.1. Changes to the project
schedule may be required to reflect the way the team is performing.
Cost baseline. Described in Section 7.3.3.1. Changes to the project
cost baseline may be required to reflect the way the team is
performing.
9.5.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. New issues raised as a result of
this process are recorded in the issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well for the managing the team.
Project team assignments. Described in Section 9.3.3.1. If changes to
the team are required, those changes are recorded in the project team
assignments documentation.
9.5.3.4 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES
Enterprise environmental factors that are updated as a result of the Manage
Team process include but are not limited to:
Input to organizational performance appraisals, and
Personnel skill.
9.6 CONTROL RESOURCES
Control Resources is the process of ensuring that the physical resources
assigned and allocated to the project are available as planned, as well as
monitoring the planned versus actual utilization of resources and taking
corrective action as necessary. The key benefit of this process is ensuring that
the assigned resources are available to the project at the right time and in the
right place and are released when no longer needed. This process is performed
throughout the project. The inputs and outputs of this process are depicted in
Figure 9-14. Figure 9-15 depicts the data flow diagram for the process.
The Control Resources process should be performed continuously in all
project phases and throughout the project life cycle. The resources needed for
the project should be assigned and released at the right time, right place, and
right amount for the project to continue without delays. The Control Resources
process is concerned with physical resources such as equipment, materials,
facilities, and infrastructure. Team members are addressed in the Manage Team
process.
The Control Resources techniques discussed here are those used most
frequently on projects. There are many others that may be useful on certain
projects or in some application areas.
Updating resource allocation requires knowing what actual resources have
been used to date and what is still needed. This is done mainly by reviewing the
performance usage to date. Control Resources is concerned with:
Monitoring resource expenditures,
Identifying and dealing with resource shortage/surplus in a timely
manner,
Ensuring that resources are used and released according to the plan
and project needs,
Informing appropriate stakeholders if any issues arise with relevant
resources,
Influencing the factors that can create resources utilization change, and
Managing the actual changes as they occur.
Any changes needed to the schedule or cost baselines can be approved only
through the Perform Integrated Change Control process (Section 4.6).
9.6.1 CONTROL RESOURCES: INPUTS
9.6.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the resource management plan. Described in Section
9.1.3.1, the resource management plan provides guidance on how physical
resources should be used, controlled, and eventually released.
9.6.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Issue log. Described in Section 4.3.3.3. The issue log is used to
identify issues such as lack of resources, delays in raw material
supplies, or low grades of raw material.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve physical resource control.
Physical resource assignments. Described in Section 9.3.3.1. The
physical resource assignments describe the expected resource
utilization along with details such as type, amount, location, and
whether the resource is internal to the organization or outsourced.
Project schedule. Described in Section 6.5.3.2. The project schedule
shows the resources that are needed, when they are needed, and the
location where they are needed.
Resource breakdown structure. Described in Section 9.2.3.3. The
resource breakdown structure provides a reference in case any
resource needs to be replaced or reacquired during the course of the
project.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements identify the needed material, equipment, supplies, and
other resources.
Risk register. Described in Section 11.2.3.1. The risk register identifies
individual risks that can impact equipment, materials, or supplies.
9.6.1.3 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on project
status such as the number and type of resources that have been used.
9.6.1.4 AGREEMENTS
Described in Section 12.2.3.2. Agreements made within the context of the
project are the basis for all resources external to the organization and should
define procedures when new, unplanned resources are needed or when issues
arise with the current resources.
9.6.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Resources
process include but are not limited to:
Policies regarding resource control and assignment,
Escalation procedures for handling issues within the performing
organization, and
Lessons learned repository from previous similar projects.
9.6.2 CONTROL RESOURCES: TOOLS AND TECHNIQUES
9.6.2.1 DATA ANALYSIS
Data analysis techniques that can be used in this process include but are not
limited to:
Alternatives analysis. Described in Section 9.2.2.5. Alternatives can be
analyzed to select the best resolution for correcting variances in
resource utilization. Alternatives such as paying additional for
overtime or additional team resources can be weighed against a late
delivery or phased deliveries.
Cost-benefit analysis. Described in Section 8.1.2.3. This analysis helps
to determine the best corrective action in terms of cost in case of
project deviations.
Performance reviews. Performance reviews measure, compare, and
analyze planned resource utilization to actual resource utilization. Cost
and schedule work performance information can also be analyzed to
help pinpoint issues that can influence resource utilization.
Trend analysis. Described in Section 4.5.2.2. As the project
progresses, the project team may use trend analysis, based on current
performance information, to determine the resources needed at
upcoming stages of the project. Trend analysis examines project
performance over time and can be used to determine whether
performance is improving or deteriorating.
9.6.2.2 PROBLEM SOLVING
Described in Section 8.2.2.7. Problem solving may use a set of tools that helps
the project manager to solve problems that arise during the control resource
process. The problem can come from inside the organization (machines or
infrastructure used by another department in the organization and not released in
time, materials that have been damaged because of unsuitable storage conditions,
etc.) or from outside the organization (major supplier that has gone bankrupt or
bad weather that has damaged resources). The project manager should use
methodical steps to deal with problem solving, which can include:
Identify the problem. Specify the problem.
Define the problem. Break it into smaller, manageable problems.
Investigate. Collect data.
Analyze. Find the root cause of the problem.
Solve. Choose the suitable solution from a variety of available ones.
Check the solution. Determine if the problem has been fixed.
9.6.2.3 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills, sometimes known as “soft skills,” are personal
competencies. The interpersonal and team skills used in this process include:
Negotiation. Described in Section 12.2.2.5. The project manager may
need to negotiate for additional physical resources, changes in physical
resources, or costs associated with the resources.
Influencing. Described in Section 9.5.2.1. Influencing can help the
project manager solve problems and obtain the resources needed in a
timely manner.
9.6.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems can
include resource management or scheduling software that can be used to monitor
the resource utilization which helps ensure that the right resources are working
on the right activities at the right time and place.
9.6.3 CONTROL RESOURCES: OUTPUTS
9.6.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how the project work is progressing by comparing resource
requirements and resource allocation to resource utilization across the project
activities. This comparison can show gaps in resource availability that need to be
addressed.
9.6.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. When change requests occur as a result of
carrying out the Control Resources process or when recommended, corrective, or
preventive actions impact any of the components of the project management
plan or project documents, the project manager needs to submit a change
request. Change requests are processed for review and disposition through the
Perform Integrated Change Control process (Section 4.6).
9.6.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan is updated to reflect actual experience in
managing project resources.
Schedule baseline. Described in Section 6.5.3.1. Changes to the project
schedule may be required to reflect the way project resources are being
managed.
Cost baseline. Described in Section 7.3.3.1. Changes to the project
cost baseline may be required to reflect the way project resources are
being managed.
9.6.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of performing this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log
may be updated with new assumptions regarding equipment, materials,
supplies, and other physical resources.
Issue log. Described in Section 4.3.3.3. New issues raised as a result of
this process are recorded in the issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were effective in
managing resource logistics, scrap, utilization variances, and
corrective actions that were used to respond to resource variances.
Physical resource assignments. Described in Section 9.3.3.1. Physical
resource assignments are dynamic and subject to change due to
availability, the project, organization, environment, or other factors.
Resource breakdown structure. Described in Section 9.2.3.3. Changes
to the resource breakdown structure may be required to reflect the way
project resources are being used.
Risk register. Described in Section 11.2.3.1. The risk register is
updated with any new risks associated with resource availability,
utilization, or other physical resource risks.
10
PROJECT COMMUNICATIONS MANAGEMENT
Project Communications Management includes the processes necessary to
ensure that the information needs of the project and its stakeholders are met
through development of artifacts and implementation of activities designed to
achieve effective information exchange. Project Communications Management
consists of two parts. The first part is developing a strategy to ensure
communication is effective for stakeholders. The second part is carrying out the
activities necessary to implement the communication strategy.
The Project Communications Management processes are:
10.1 Plan Communications Management—The process of developing an
appropriate approach and plan for project communication activities based on the
information needs of each stakeholder or group, available organizational assets,
and the needs of the project.
10.2 Manage Communications—The process of ensuring timely and
appropriate collection, creation, distribution, storage, retrieval, management,
monitoring, and the ultimate disposition of project information.
10.3 Monitor Communications—The process of ensuring the information
needs of the project and its stakeholders are met.
Figure 10-1 provides an overview of the Project Communications
Management processes. The Project Communications Management processes
are presented as discrete processes with defined interfaces while, in practice,
they overlap and interact in ways that cannot be completely detailed in the
PMBOK® Guide.
KEY CONCEPTS FOR PROJECT COMMUNICATIONS MANAGEMENT
Communication is the exchange of information, intended or involuntary. The
information exchanged can be in the form of ideas, instructions, or emotions.
The mechanisms by which information is exchanged can be in:
Written form. Either physical or electronic.
Spoken. Either face-to-face or remote.
Formal or informal (as in formal papers or social media).
Through gestures. Tone of voice and facial expressions.
Through media. Pictures, actions, or even just the choice of words.
Choice of words. There is often more than one word to express an
idea; there can be subtle differences in the meaning of each of these
words and phrases.
Communications describe the possible means by which the information can be
sent or received, either through communication activities, such as meetings and
presentations, or artifacts, such as emails, social media, project reports, or
project documentation.
Project managers spend most of their time communicating with team members
and other project stakeholders, both internal (at all organizational levels) and
external to the organization. Effective communication builds a bridge between
diverse stakeholders who may have different cultural and organizational
backgrounds as well as different levels of expertise, perspectives, and interests.
Communication activities have many dimensions, including but not limited to:
Internal. Focus on stakeholders within the project and within the
organization.
External. Focus on external stakeholders such as customers, vendors,
other projects, organizations, government, the public, and
environmental advocates.
Formal. Reports, formal meetings (both regular and ad hoc), meeting
agendas and minutes, stakeholder briefings, and presentations.
Informal. General communications activities using emails, social
media, websites, and informal ad hoc discussions.
Hierarchical focus. The position of the stakeholder or group with
respect to the project team will affect the format and content of the
message, in the following ways:
Upward. Senior management stakeholders.
Downward. The team and others who will contribute to the work of
the project.
Horizontal. Peers of the project manager or team.
Official. Annual reports; reports to regulators or government bodies.
Unofficial. Communications that focus on establishing and
maintaining the profile and recognition of the project and building
strong relationships between the project team and its stakeholders
using flexible and often informal means.
Written and oral. Verbal (words and voice inflections) and nonverbal
(body language and actions), social media and websites, media
releases.
Communication develops the relationships necessary for successful project
and program outcomes. Communication activities and artifacts to support
communication vary widely, ranging from emails and informal conversations to
formal meetings and regular project reports. The act of sending and receiving
information takes place consciously or unconsciously through words, facial
expressions, gestures and other actions. In the context of successfully managing
project relationships with stakeholders, communication includes developing
strategies and plans for suitable communications artifacts and activities with the
stakeholder community and the application of skills to enhance the effectiveness
of the planned and other ad hoc communications.
There are two parts to successful communication. The first part involves
developing an appropriate communication strategy based on both the needs of
the project and the project's stakeholders. From that strategy, a communications
management plan is developed to ensure that the appropriate messages are
communicated to stakeholders in various formats and various means as defined
by the communication strategy. These messages constitute the project's
communications—the second part of successful communication. Project
communications are the products of the planning process, addressed by the
communications management plan that defines the collection, creation,
dissemination, storage, retrieval, management, tracking, and disposition of these
communications artifacts. Finally, the communication strategy and
communications management plan will form the foundation to monitor the effect
of the communication.
The project's communications are supported by efforts to prevent
misunderstandings and miscommunication and by careful selection of the
methods, messengers, and messages developed from the planning process.
Misunderstandings can be reduced but not eliminated through using the 5Cs
of written communications in composing a traditional (non-social media) written
or spoken message:
Correct grammar and spelling. Poor use of grammar or inaccurate
spelling can be distracting and can also introduce distortions in the
message, diminishing credibility.
Concise expression and elimination of excess words. A concise, well-
crafted message reduces the opportunities for misunderstanding the
intent of the message.
Clear purpose and expression directed to the needs of the reader.
Ensure that the needs and interests of the audience are factored into the
message.
Coherent logical flow of ideas. A coherent logical flow of ideas and
using “markers” such as introduction and summaries of the ideas
throughout the writing.
Controlling flow of words and ideas. Controlling the flow of words
and ideas may involve graphics or just summaries.
The 5Cs of written communications are supported by communication skills,
such as:
Listening actively. Staying engaged with the speaker and summarizing
conversations to ensure effective information exchange.
Awareness of cultural and personal differences. Developing the team's
awareness of cultural and personal differences to reduce
misunderstandings and enhance communication capability.
Identifying, setting, and managing stakeholder expectations.
Negotiating with stakeholders reduces the existence of conflicting
expectations among the stakeholder community.
Enhancement of skills. Enhancing the skills of all team members in the
following activities:
Persuading a person, a team, or an organization to perform an action;
Motivating people and providing encouragement or reassurance;
Coaching to improve performance and achieve desired results;
Negotiating to achieve mutually acceptable agreements between
parties and reduce approval or decision delays; and
Resolving conflict to prevent disruptive impacts.
The fundamental attributes of effective communication activities and
developing effective communication artifacts are:
Clarity on the purpose of the communication—defining its purpose;
Understanding as much as possible about the receiver of the
communications, meeting needs, and preferences; and
Monitoring and measuring the effectiveness of the communications.
TRENDS AND EMERGING PRACTICES IN PROJECT
COMMUNICATIONS MANAGEMENT
Along with a focus on stakeholders and recognition of the value to projects
and organizations of effective stakeholder engagement comes the recognition
that developing and implementing appropriate communication strategies is vital
to maintaining effective relationships with stakeholders. Trends and emerging
practices for Project Communications Management include but are not limited
to:
Inclusion of stakeholders in project reviews. The stakeholder
community of each project includes individuals, groups, and
organizations that the project team has identified as essential to the
successful delivery of project objectives and organizational outcomes.
An effective communication strategy requires regular and timely
reviews of the stakeholder community and updates to manage changes
in its membership and attitudes.
Inclusion of stakeholders in project meetings. Project meetings should
include stakeholders from outside the project and even the
organization, where appropriate. Practices inherent in the agile
approaches can be applied to all types of projects. Practices often
include short, daily standup meetings, where the achievements and
issues of the previous day, and plans for the current day's work, are
discussed with the project team and key stakeholders.
Increased use of social computing. Social computing in the form of
infrastructure, social media services, and personal devices has changed
how organizations and their people communicate and do business.
Social computing incorporates different approaches to collaboration
supported by public IT infrastructure. Social networking refers to how
users build networks of relationships to explore their interests and
activities with others. Social media tools can not only support
information exchange, but also build relationships accompanied by
deeper levels of trust and community.
Multifaceted approaches to communication. The standard
communication strategy for project stakeholder communications
embraces and selects from all technologies and respects cultural,
practical, and personal preferences for language, media, content, and
delivery. When appropriate, social media and other advanced
computing technologies may be included. Multifaceted approaches
such as these are more effective for communicating to stakeholders
from different generations and cultures.
TAILORING CONSIDERATIONS
Because each project is unique, the project team will need to tailor the way
that Project Communications Management processes are applied. Considerations
for tailoring include but are not limited to:
Stakeholders. Are the stakeholders internal or external to the
organization, or both?
Physical location. What is the physical location of team members? Is
the team colocated? Is the team in the same geographical area? Is the
team distributed across multiple time zones?
Communications technology. What technology is available to develop,
record, transmit, retrieve, track, and store communication artifacts?
What technologies are most appropriate and cost effective for
communicating to stakeholders?
Language. Language is a main factor to consider in communication
activities. Is one language used? Or are many languages used? Have
allowances been made to adjust to the complexity of team members
from diverse language groups?
Knowledge management. Does the organization have a formal
knowledge management repository? Is the repository used?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Project environments subject to various elements of ambiguity and change
have an inherent need to communicate evolving and emerging details more
frequently and quickly. This motivates streamlining team member access to
information, frequent team checkpoints, and colocating team members as much
as possible.
In addition, posting project artifacts in a transparent fashion, and holding
regular stakeholder reviews are intended to promote communication with
management and stakeholders.
10.1 PLAN COMMUNICATIONS MANAGEMENT
Plan Communications Management is the process of developing an
appropriate approach and plan for project communications activities based on
the information needs of each stakeholder or group, available organizational
assets, and the needs of the project. The key benefit of this process is a
documented approach to effectively and efficiently engage stakeholders by
presenting relevant information in a timely manner. This process is performed
periodically throughout the project as needed. The inputs, tools and techniques,
and outputs of the process are depicted in Figure 10-2. Figure 10-3 depicts the
data flow diagram for the process.
An effective communications management plan that recognizes the diverse
information needs of the project's stakeholders is developed early in the project
life cycle. It should be reviewed regularly and modified when necessary, when
the stakeholder community changes or at the start of each new project phase.
On most projects, communications planning is performed very early, during
stakeholder identification and project management plan development.
While all projects share the need to communicate project information, the
information needs and methods of distribution may vary widely. In addition, the
methods of storage, retrieval, and ultimate disposition of the project information
need to be considered and documented during this process. The results of the
Plan Communications Management process should be reviewed regularly
throughout the project and revised as needed to ensure continued applicability.
10.1.1 PLAN COMMUNICATIONS MANAGEMENT: INPUTS
10.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter identifies the key stakeholder
list. It may also contain information about the roles and responsibilities of the
stakeholders.
10.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. Provides
guidance on how team resources will be categorized, allocated,
managed, and released. Team members and groups may have
communication requirements that should be identified in the
communications management plan.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan identifies the management strategies
required to effectively engage stakeholders. These strategies are often
fulfilled via communications.
10.1.1.3 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation can include project stakeholder
communications.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register is used to plan communications activities with stakeholders.
10.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan
Communications Management process include but are not limited to:
Organizational culture, political climate, and governance framework;
Personnel administration policies;
Stakeholder risk thresholds;
Established communication channels, tools, and systems;
Global, regional, or local trends, practices, or habits; and
Geographic distribution of facilities and resources.
10.1.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Communications
Management process include but are not limited to:
Organizational policies and procedures for social media, ethics, and
security;
Organizational policies and procedures for issue, risk, change, and data
management;
Organizational communication requirements;
Standardized guidelines for development, exchange, storage, and
retrieval of information;
Historical information and lessons learned repository; and
Stakeholder and communications data and information from previous
projects.
10.1.2 PLAN COMMUNICATIONS MANAGEMENT: TOOLS
AND TECHNIQUES
10.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Politics and power structures in the organization;
Environment and culture of the organization and other customer
organizations;
Organizational change management approach and practices;
Industry or type of project deliverables;
Organizational communications technologies;
Organizational policies and procedures regarding legal requirements of
corporate communications;
Organizational policies and procedures regarding security; and
Stakeholders, including customers or sponsors.
10.1.2.2 COMMUNICATION REQUIREMENTS ANALYSIS
Analysis of communication requirements determines the information needs of
the project stakeholders. These requirements are defined by combining the type
and format of information needed with an analysis of the value of that
information.
Sources of information typically used to identify and define project
communication requirements include but are not limited to:
Stakeholder information and communication requirements from within
the stakeholder register and stakeholder engagement plan;
Number of potential communication channels or paths, including one-
to-one, one-to-many, and many-to-many communications;
Organizational charts;
Project organization and stakeholder responsibility, relationships, and
interdependencies;
Development approach;
Disciplines, departments, and specialties involved in the project;
Logistics of how many persons will be involved with the project and at
which locations;
Internal information needs (e.g., when communicating within
organizations);
External information needs (e.g., when communicating with the media,
public, or contractors); and
Legal requirements.
10.1.2.3 COMMUNICATION TECHNOLOGY
The methods used to transfer information among project stakeholders may
vary significantly. Common methods used for information exchange and
collaboration include conversations, meetings, written documents, databases,
social media, and websites.
Factors that can affect the choice of communication technology include:
Urgency of the need for information. The urgency, frequency, and
format of the information to be communicated may vary from project
to project and also within different phases of a project.
Availability and reliability of technology. The technology that is
required for distribution of project communications artifacts should be
compatible, available, and accessible for all stakeholders throughout
the project.
Ease of use. The choice of communication technologies should be
suitable for project participants and proper training events should be
planned, where appropriate.
Project environment. Whether the team will meet and operate on a
face-to-face basis or in a virtual environment; whether they will be
located in one or multiple time zones; whether they will use multiple
languages for communication; and finally, whether there are any other
project environmental factors, such as various aspects of culture,
which may constrain the efficiency of the communication.
Sensitivity and confidentiality of the information. Some aspects to
consider are:
Whether information to be communicated is sensitive or confidential.
If so, additional security measures may be required.
Social media policies for employees to ensure appropriate behavior,
security, and the protection of proprietary information.
10.1.2.4 COMMUNICATION MODELS
Communication models can represent the communication process in its most
basic linear form (sender and receiver), in a more interactive form that
encompasses the additional element of feedback (sender, receiver, and
feedback), or in a more complex model that incorporates the human elements of
the sender(s) or receiver(s) and attempts to show the complexity of any
communication that involves people.
Sample basic sender/receiver communication model. This model
describes communication as a process and consists of two parties,
defined as the sender and receiver. This model is concerned with
ensuring that the message is delivered, rather than understood. The
sequence of steps in a basic communication model is:
Encode. The message is coded into symbols, such as text, sound or
some other medium for transmission (sending).
Transmit message. The message is sent via a communication
channel. The transmission of this message may be compromised by
various physical factors such as unfamiliar technology or inadequate
infrastructure. Noise and other factors may be present and contribute
to loss of information in transmission and/or reception of the
message.
Decode. The data received is translated by the receiver back into a
form useful to the receiver.
Sample interactive communication model. This model also describes
communication as a process consisting of two parties, the sender and
receiver, but recognizes the need to ensure that the message has been
understood. In this model, noise includes any interference or barriers
that might compromise the understanding of the message, such as the
distraction of the receiver, variations in the perceptions of receivers, or
lack of appropriate knowledge or interest. The additional steps in an
interactive communication model are:
Acknowledge. Upon receipt of a message, the receiver may signal
(acknowledge) receipt of the message, but this does not necessarily
mean agreement with or comprehension of the message—merely that
it has been received.
Feedback/response. When the received message has been decoded
and understood, the receiver encodes thoughts and ideas into a
message and then transmits this message to the original sender. If the
sender perceives that the feedback matches the original message, the
communication has been successful. In communication between
people, feedback can be achieved through active listening, described
in Section 10.2.2.6.
As part of the communication process, the sender is responsible for the
transmission of the message, ensuring the information being communicated
is clear and complete, and confirming the message is correctly interpreted.
The receiver is responsible for ensuring that the information is received in
its entirety, interpreted correctly, and acknowledged or responded to
appropriately. These components take place in an environment where there
will likely be noise and other barriers to effective communication.
Cross-cultural communication presents challenges to ensuring that the
meaning of the message has been understood. Differences in communication
styles can arise from differences in working methods, age, nationality,
professional discipline, ethnicity, race, or gender. People from different cultures
communicate using different languages (e.g., technical design documents,
different styles) and expect different processes and protocols.
The communication model shown in Figure 10-4 incorporates the idea that the
message itself and how it is transmitted are influenced by the sender's current
emotional state, knowledge, background, personality, culture, and biases.
Similarly, the receiver's emotional state knowledge, background, personality,
culture, and biases will influence how the message is received and interpreted,
and will contribute to the barriers or noise.
This communication model and its enhancements can assist in developing
communication strategies and plans for person-to-person or even small group to
small group communications. It is not useful for other communications artifacts
such as emails, broadcast messages, or social media.
10.1.2.5 COMMUNICATION METHODS
There are several communication methods that are used to share information
among project stakeholders. These methods are broadly classified as follows:
Interactive communication. Between two or more parties performing a
multidirectional exchange of information in real time. It employs
communications artifacts such as meetings, phone calls, instant
messaging, some forms of social media, and videoconferencing.
Push communication. Sent or distributed directly to specific recipients
who need to receive the information. This ensures that the information
is distributed but does not ensure that it actually reached or was
understood by the intended audience. Push communications artifacts
include letters, memos, reports, emails, faxes, voice mails, blogs, and
press releases.
Pull communication. Used for large complex information sets, or for
large audiences, and requires the recipients to access content at their
own discretion subject to security procedures. These methods include
web portals, intranet sites, e-learning, lessons learned databases, or
knowledge repositories.
Different approaches should be applied to meet the needs of the major forms
of communication defined in the communications management plan:
Interpersonal communication. Information is exchanged between
individuals, typically face-to-face.
Small group communication. Occurs within groups of around three to
six people.
Public communication. A single speaker addressing a group of people.
Mass communication. There is a minimal connection between the
person or group sending the message and the large, sometimes
anonymous groups for whom the information is intended.
Networks and social computing communication. Supports emerging
communication trends of many-to-many supported by social
computing technology and media.
Possible communications artifacts and methods include but are not limited to:
Notice boards,
Newsletters/in-house magazines/e-magazines,
Letters to staff/volunteers,
Press releases,
Annual reports,
Emails and intranets,
Web portals and other information repositories (for pull
communication)
Phone conversations,
Presentations,
Team briefings/group meetings,
Focus groups,
Face-to-face formal or informal meetings between various
stakeholders,
Consultation groups or staff forums, and
Social computing technology and media.
10.1.2.6 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Communication styles assessment. A technique used to assess
communication styles and identify the preferred communication
method, format, and content for planned communication activities.
Often used with unsupportive stakeholders, this assessment may
follow a stakeholder engagement assessment (described in Section
13.2.2.5) to identify gaps in stakeholder engagement that require
additional tailored communication activities and artifacts.
Political awareness. Political awareness helps the project manager to
plan communications based on the project environment as well as the
organization's political environment. Political awareness concerns the
recognition of power relationships, both formal and informal, and also
the willingness to operate within these structures. An understanding of
the strategies of the organization, knowing who wields power and
influence in this arena, and developing an ability to communicate with
these stakeholders are all aspects of political awareness.
Cultural awareness. Cultural awareness is an understanding of the
differences between individuals, groups, and organizations and
adapting the project's communication strategy in the context of these
differences. This awareness and any consequent actions minimize
misunderstandings and miscommunication that may result from
cultural differences within the project's stakeholder community.
Cultural awareness and cultural sensitivity help the project manager to
plan communications based on the cultural differences and
requirements of stakeholders and team members.
10.1.2.7 DATA REPRESENTATION
A data representation technique that can be used for this process includes but
is not limited to a stakeholder engagement assessment matrix. Described in
Section 13.2.2.5. The stakeholder engagement assessment matrix, shown in
Figure 13-6, displays gaps between current and desired engagement levels of
individual stakeholders, it can be further analyzed in this process to identify
additional communication requirements (beyond the regular reports) as a method
to close any engagement level gaps.
10.1.2.8 MEETINGS
Project meetings can include virtual (e-meetings) or face-to-face meetings,
and can be supported with document collaboration technologies, including email
messages and project websites. The Plan Communications Management process
requires discussion with the project team to determine the most appropriate way
to update and communicate project information, and to respond to requests from
various stakeholders for information.
10.1.3 PLAN COMMUNICATIONS MANAGEMENT: OUTPUTS
10.1.3.1 COMMUNICATIONS MANAGEMENT PLAN
The communications management plan is a component of the project
management plan that describes how project communications will be planned,
structured, implemented, and monitored for effectiveness. The plan contains the
following information:
Stakeholder communication requirements;
Information to be communicated, including language, format, content,
and level of detail;
Escalation processes;
Reason for the distribution of that information;
Timeframe and frequency for the distribution of required information
and receipt of acknowledgment or response, if applicable;
Person responsible for communicating the information;
Person responsible for authorizing release of confidential information;
Person or groups who will receive the information, including
information about their needs, requirements, and expectations;
Methods or technologies used to convey the information, such as
memos, email, press releases, or social media;
Resources allocated for communication activities, including time and
budget;
Method for updating and refining the communications management
plan as the project progresses and develops, such as when the
stakeholder community changes as the project moves through different
phases;
Glossary of common terminology;
Flow charts of the information flow in the project, workflows with
possible sequence of authorization, list of reports, meeting plans, etc.;
and
Constraints derived from specific legislation or regulation, technology,
organizational policies, etc.
The communications management plan can include guidelines and templates
for project status meetings, project team meetings, e-meetings, and email
messages. The use of a project website and project management software can be
included if these are to be used in the project.
10.1.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to
the stakeholder engagement plan, which is described in Section 13.2.3.1. The
stakeholder engagement plan is updated to reflect any processes, procedures,
tools, or techniques that affect the engagement of stakeholders in project
decisions and execution.
10.1.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Project schedule. Described in Section 6.5.3.2. The project schedule
may be updated to reflect communication activities.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register may be updated to reflect communications planned.
10.2 MANAGE COMMUNICATIONS
Manage Communications is the process of ensuring timely and appropriate
collection, creation, distribution, storage, retrieval, management, monitoring, and
the ultimate disposition of project information. The key benefit of this process is
that it enables an efficient and effective information flow between the project
team and the stakeholders. This process is performed throughout the project.
The Manage Communications process identifies all aspects of effective
communication, including choice of appropriate technologies, methods, and
techniques. In addition, it should allow for flexibility in the communications
activities, allowing adjustments in the methods and techniques to accommodate
the changing needs of stakeholders and the project. The inputs, tools, techniques,
and outputs of this process are depicted in Figure 10-5. Figure 10-6 depicts the
data flow diagram of the Manage Communications process.
This process goes beyond the distribution of relevant information and seeks to
ensure that the information being communicated to project stakeholders has been
appropriately generated and formatted, and received by the intended audience. It
also provides opportunities for stakeholders to make requests for further
information, clarification, and discussion. Techniques and considerations for
effective communications management include but are not limited to:
Sender-receiver models. Incorporating feedback loops to provide
opportunities for interaction/participation and remove barriers to
effective communication.
Choice of media. Decisions about application of communications
artifacts to meet specific project needs, such as when to communicate
in writing versus orally, when to prepare an informal memo versus a
formal report, and when to use push/pull options and the choice of
appropriate technology.
Writing style. Appropriate use of active versus passive voice, sentence
structure, and word choice.
Meeting management. Described in Section 10.2.2.6. Preparing an
agenda, inviting essential participants, and ensuring they attend.
Dealing with conflicts within the meeting or resulting from inadequate
follow-up of minutes and actions, or attendance of the wrong people.
Presentations. Awareness of the impact of body language and design
of visual aids.
Facilitation. Described in Section 4.1.2.3. Building consensus and
overcoming obstacles such as difficult group dynamics, and
maintaining interest and enthusiasm among group members.
Active listening. Described in Section 10.2.2.6. Listening actively
involves acknowledging, clarifying and confirming, understanding,
and removing barriers that adversely affect comprehension.
10.2.1 MANAGE COMMUNICATIONS: INPUTS
10.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan describes the communications that are
needed for management of team or physical resources.
Communications management plan. Described in Section 10.1.3.1.
The communications management plan describes how project
communications will be planned, structured, monitored, and
controlled.
Stakeholder engagement plan. Described in detail in Section 13.2.3.1.
The stakeholder engagement plan describes how stakeholders will be
engaged through appropriate communication strategies.
10.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to
Change log. Described in Section 4.6.3.3. The change log is used to
communicate changes and approved, deferred, and rejected change
requests to the impacted stakeholders.
Issue log. Described in Section 4.6.3.3. Information about issues is
communicated to impacted stakeholders.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to managing communications can be
applied to later phases in the project to improve the efficiency and
effectiveness of communications and the communication process.
Quality report. Described in Section 8.2.3.1. Information in the quality
report includes quality issues, project and product improvements, and
process improvements. This information is forwarded to those who can
take corrective actions in order to achieve the project quality
expectations.
Risk report. Described in Section 11.2.3.2. The risk report presents
information on sources of overall project risk, together with summary
information on identified individual project risks. This information is
communicated to risk owners and other impacted stakeholders.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register identifies the individuals, groups, or organizations that will
need various types of information.
10.2.1.3 WORK PERFORMANCE REPORTS
Described in Section 4.5.3.1. Work performance reports are circulated to the
project stakeholders through this process as defined in the communications
management plan. Examples of work performance reports include status reports
and progress reports. Work performance reports can contain earned value graphs
and information, trend lines and forecasts, reserve burndown charts, defect
histograms, contract performance information, and risk summaries. They can be
presented as dashboards, heat reports, stop light charts, or other representations
useful for creating awareness and generating decisions and actions.
10.2.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence this process include
but are not limited to:
Organizational culture, political climate, and governance framework;
Personnel administration policies;
Stakeholder risk thresholds;
Established communication channels, tools, and systems;
Global, regional, or local trends and practices or habits; and
Geographic distribution of facilities and resources.
10.2.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence this process include but
are not limited to:
Corporate policies and procedures for social media, ethics, and
security;
Corporate policies and procedures for issue, risk, change, and data
management;
Organizational communication requirements;
Standardized guidelines for development, exchange, storage, and
retrieval of information; and
Historical information from previous projects, including the lessons
learned repository.
10.2.2 MANAGE COMMUNICATIONS: TOOLS AND
TECHNIQUES
10.2.2.1 COMMUNICATION TECHNOLOGY
Described in Section 10.1.2.3. Factors that influence the technology include
whether the team is colocated, the confidentiality of any information that needs
to be shared, resources available to the team members, and how the
organization's culture influences the way in which meetings and discussions are
normally conducted.
10.2.2.2 COMMUNICATION METHODS
Described in Section 10.1.2.5. The choice of communication methods should
allow flexibility in the event that the membership of the stakeholder community
changes or their needs and expectations change.
10.2.2.3 COMMUNICATION SKILLS
Communication techniques that can be used for this process include but are
not limited to:
Communication competence. A combination of tailored
communication skills that considers factors such as clarity of purpose
in key messages, effective relationships and information sharing, and
leadership behaviors.
Feedback. Feedback is information about reactions to
communications, a deliverable, or a situation. Feedback supports
interactive communication between the project manager, team and all
other project stakeholders. Examples include coaching, mentoring, and
negotiating.
Nonverbal. Examples of nonverbal communication include appropriate
body language to transmit meaning through gestures, tone of voice,
and facial expressions. Mirroring and eye contact are also important
techniques. The team members should be aware of how they are
expressing themselves both through what they say and what they don't
say.
Presentations. A presentation is the formal delivery of information
and/or documentation. Clear and effective presentations of project
information to relevant stakeholders can include but are not limited to:
Progress reports and information updates to stakeholders;
Background information to support decision making;
General information about the project and its objectives, for the
purposes of raising the profile of the work of the project and the
team; and
Specific information aimed at increasing understanding and support
of the work and objectives of the project.
Presentations will be successful when the content and delivery take the
following into account:
The audience, their expectations, and needs; and
The needs and objectives of the project and project team.
10.2.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems can
ensure that stakeholders can easily retrieve the information they need in a timely
way. Project information is managed and distributed using a variety of tools,
including:
Electronic project management tools. Project management software,
meeting and virtual office support software, web interfaces,
specialized project portals and dashboards, and collaborative work
management tools.
Electronic communications management. Email, fax, and voice mail;
audio, video and web conferencing; and websites and web publishing.
Social media management. Websites and web publishing; and blogs
and applications, which offer the opportunity to engage with
stakeholders and form online communities.
10.2.2.5 PROJECT REPORTING
Project reporting is the act of collecting and distributing project information.
Project information is distributed to many groups of stakeholders and should be
adapted to provide information at an appropriate level, format, and detail for
each type of stakeholder. The format may range from a simple communication to
more elaborate custom reports and presentations. Information may be prepared
regularly or on an exception basis. While work performance reports are the
output of the Monitor and Control Project Work process, this process develops
ad hoc reports, project presentations, blogs, and other types of communication
about the project.
10.2.2.6 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Active listening. Techniques of active listening involve
acknowledging, clarifying and confirming, understanding, and
removing barriers that adversely affect comprehension.
Conflict management. Described in Section 9.5.2.1.
Cultural awareness. Described in Section 10.1.2.6.
Meeting management. Meeting management is taking steps to ensure
meetings meet their intended objectives effectively and efficiently.
The following steps should be used for meeting planning:
Prepare and distribute the agenda stating the objectives of the
meeting.
Ensure that the meetings start and finish at the published time.
Ensure the appropriate participants are invited and attend.
Stay on topic.
Manage expectations, issues, and conflicts during the meeting.
Record all actions and those who have been allocated the
responsibility for completing the action.
Networking. Networking is interacting with others to exchange
information and develop contacts. Networks provide project managers
and their teams with access to informal organizations to solve
problems, influence actions of their stakeholders, and increase
stakeholder support for the work and outcomes of the project, thus
improving performance.
Political awareness. Described in Section 10.1.2.6. Political awareness
assists the project manager in engaging stakeholders appropriately to
maintain their support throughout the project.
10.2.2.7 MEETINGS
Meetings support the actions defined in the communication strategy and
communications plan.
10.2.3 MANAGE COMMUNICATIONS: OUTPUTS
10.2.3.1 PROJECT COMMUNICATIONS
Project communications artifacts may include but are not limited to:
performance reports, deliverable status, schedule progress, cost incurred,
presentations, and other information required by stakeholders.
10.2.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may be updated as a result of carrying out this process
include but are not limited to:
Communications management plan. Described in Section 10.1.3.1.
When changes are made to the project communications approach as a
result of this process, these changes are reflected in the project
communications plan.
Stakeholder engagement plan. Described in Section 13.2.3.1.
Stakeholder communication requirements and agreed-upon
communications strategies are updated as a result of this process.
10.2.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Sections 4.3.3.3. The issue log is updated to
reflect any communication issues on the project, or how any
communications have been used to impact active issues.
Lessons learned register. Described in Section 4.3.3.1. The lessons
learned register is updated with information on challenges encountered
and how they could have been avoided as well as approaches that
worked well and what did not work well for managing
communications.
Project schedule. Described in Section 6.5.3.2. The project schedule
may be updated to reflect the status of communication activities.
Risk register. Described in Section 11.2.3.1. The risk register is
updated to capture risks associated with managing communications.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register can be updated to include information regarding
communications activities with project stakeholders.
10.2.3.4 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that may be updated as a result of this process
include but are not limited to:
Project records such as correspondence, memos, meeting minutes and
other documents used on the project; and
Planned and ad hoc project reports and presentations.
10.3 MONITOR COMMUNICATIONS
Monitor Communications is the process of ensuring the information needs of
the project and its stakeholders are met. The key benefit of this process is the
optimal information flow as defined in the communications management plan
and the stakeholder engagement plan. This process is performed throughout the
project. The inputs, tools and techniques, and outputs of the process are depicted
in Figure 10-7. Figure 10-8 depicts the data flow diagram for the process.
Monitor Communications determines if the planned communications artifacts
and activities have had the desired effect of increasing or maintaining
stakeholders’ support for the project's deliverables and expected outcomes. The
impact and consequences of project communications should be carefully
evaluated and monitored to ensure that the right message with the right content
(the same meaning for sender and receiver) is delivered to the right audience,
through the right channel, and at the right time. Monitor Communications may
require a variety of methods, such as customer satisfaction surveys, collecting
lessons learned, observations of the team, reviewing data from the issue log, or
evaluating changes in the stakeholder engagement assessment matrix described
in Section 13.2.2.5.
The Monitor Communications process can trigger an iteration of the Plan
Communications Management and/or Manage Communications processes to
improve effectiveness of communication through additional and possibly
amended communications plans and activities. Such iterations illustrate the
continuous nature of the Project Communications Management processes. Issues
or key performance indicators, risks, or conflicts may trigger an immediate
revision.
10.3.1 MONITOR COMMUNICATIONS: INPUTS
10.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan can be used to understand the actual project
organization and any changes through understanding of roles and
responsibilities and the project organization charts.
Communications management plan. Described in Section 10.1.3.1.
The communications management plan contains the current plan for
collecting, creating, and distributing information in a timely manner. It
identifies the team members, stakeholders, and the work involved in
the communication process.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan identifies the communication strategies
that are planned to engage stakeholders.
10.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Issue log. Described in Section 4.3.3.3. The issue log provides the
project's history, a record of stakeholder engagement issues, and how
they were resolved.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied to later phases in the project to
improve communication effectiveness.
Project communications. Described in Section 10.2.3.1. Provides
information about communications that have been distributed.
10.3.1.3 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on the
types and quantities of communications that have actually been distributed.
10.3.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Monitor
Communications process include but are not limited to:
Organizational culture, political climate, and governance framework;
Established communication channels, tools, and systems;
Global, regional, or local trends, practices, or habits; and
Geographic distribution of facilities and resources.
10.3.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that may influence the Monitor
Communications process include but are not limited to:
Corporate policies and procedures for social media, ethics, and
security;
Organizational communication requirements;
Standardized guidelines for development, exchange, storage, and
retrieval of information;
Historical information and lessons learned repository from previous
projects; and
Stakeholder and communications data and information from previous
projects.
10.3.2 MONITOR COMMUNICATIONS: TOOLS AND
TECHNIQUES
10.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Communications with the public, the community, and the media, and,
in an international environment, between virtual groups; and
Communications and project management systems.
10.3.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems
provides a set of standard tools for the project manager to capture, store, and
distribute information to internal and external stakeholders with the information
they need according the communications plan. The information contained in the
system is monitored to assess its validity and effectiveness.
10.3.2.3 DATA REPRESENTATION
A data representation technique that can be used includes but is not limited to
the stakeholder engagement assessment matrix (Section 13.2.2.5), which can
provide information about the effectiveness of the communications activities.
This is achieved by reviewing changes between desired and current engagement
and adjusting communications as necessary.
10.3.2.4 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to observation/conversation as described in Section 5.2.2.6.
Discussion and dialogue with the project team helps determine the most
appropriate way to update and communicate project performance, and to respond
to requests from stakeholders for information. Observation and conversation
enables the project manager to identify issues within the team, conflicts between
people, or individual performance issues.
10.3.2.5 MEETINGS
Face-to-face or virtual meetings are used for decision making; responding to
stakeholder requests; and having discussions with suppliers, vendors, and other
project stakeholders.
10.3.3 MONITOR COMMUNICATIONS: OUTPUTS
10.3.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how project communication is performing by comparing the
communications that were implemented compared to those that were planned. It
also considers feedback on communications, such as survey results on
communication effectiveness.
10.3.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. The Monitor Communications process often
results in the need for adjustment, action, and intervention on communications
activities defined in the communications management plan. Change requests are
processed through the Perform Integrated Change Control process (Section 4.6).
These change requests may result in:
Revision of stakeholder communication requirements, including
stakeholders’ information distribution, content or format, and
distribution method; and
New procedures to eliminate bottlenecks.
10.3.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Communications management plan. Described in Section 10.1.3.1.
The communications management plan is updated with new
information to make communication more effective.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan is updated to reflect the actual situation
of stakeholders, their communication needs, and their importance.
10.3.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. The issue log may be updated
with new information on issues raised, their progress, and resolution.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register may be updated with causes of issues, reasons behind
the corrective actions chosen, and other communication lessons
learned as appropriate.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register may be updated with revised stakeholder communication
requirements.
11
PROJECT RISK MANAGEMENT
Project Risk Management includes the processes of conducting risk
management planning, identification, analysis, response planning, response
implementation, and monitoring risk on a project. The objectives of project risk
management are to increase the probability and/or impact of positive risks and to
decrease the probability and/or impact of negative risks, in order to optimize the
chances of project success.
The Project Risk Management processes are:
11.1 Plan Risk Management—The process of defining how to conduct risk
management activities for a project.
11.2 Identify Risks—The process of identifying individual project risks as
well as sources of overall project risk, and documenting their characteristics.
11.3 Perform Qualitative Risk Analysis—The process of prioritizing
individual project risks for further analysis or action by assessing their
probability of occurrence and impact as well as other characteristics.
11.4 Perform Quantitative Risk Analysis—The process of numerically
analyzing the combined effect of identified individual project risks and other
sources of uncertainty on overall project objectives.
11.5 Plan Risk Responses—The process of developing options, selecting
strategies, and agreeing on actions to address overall project risk exposure, as
well as to treat individual project risks.
11.6 Implement Risk Responses—The process of implementing agreed-upon
risk response plans.
11.7 Monitor Risks—The process of monitoring the implementation of
agreed-upon risk response plans, tracking identified risks, identifying and
analyzing new risks, and evaluating risk process effectiveness throughout the
project.
Figure 11-1 provides an overview of the Project Risk Management processes.
The Project Management Risk processes are presented as discrete processes with
defined interfaces while, in practice, they overlap and interact in ways that
cannot be completely detailed in this PMBOK® Guide.
KEY CONCEPTS FOR PROJECT RISK MANAGEMENT
All projects are risky since they are unique undertakings with varying degrees
of complexity that aim to deliver benefits. They do this in a context of
constraints and assumptions, while responding to stakeholder expectations that
may be conflicting and changing. Organizations should choose to take project
risk in a controlled and intentional manner in order to create value while
balancing risk and reward.
Project Risk Management aims to identify and manage risks that are not
addressed by the other project management processes. When unmanaged, these
risks have the potential to cause the project to deviate from the plan and fail to
achieve the defined project objectives. Consequently, the effectiveness of Project
Risk Management is directly related to project success.
Risk exists at two levels within every project. Each project contains individual
risks that can affect the achievement of project objectives. It is also important to
consider the riskiness of the overall project, which arises from the combination
of individual project risks and other sources of uncertainty. Project Risk
Management processes address both levels of risk in projects, and these are
defined as follows:
Individual project risk is an uncertain event or condition that, if it
occurs, has a positive or negative effect on one or more project
objectives.
Overall project risk is the effect of uncertainty on the project as a
whole, arising from all sources of uncertainty including individual
risks, representing the exposure of stakeholders to the implications of
variations in project outcome, both positive and negative.
Individual project risks can have a positive or negative effect on project
objectives if they occur. Project Risk Management aims to exploit or enhance
positive risks (opportunities) while avoiding or mitigating negative risks
(threats). Unmanaged threats may result in issues or problems such as delay, cost
overruns, performance shortfall, or loss of reputation. Opportunities that are
captured can lead to benefits such as reduced time and cost, improved
performance, or reputation.
Overall project risk can also be positive or negative. Management of overall
project risk aims to keep project risk exposure within an acceptable range by
reducing drivers of negative variation, promoting drivers of positive variation,
and maximizing the probability of achieving overall project objectives.
Risks will continue to emerge during the lifetime of the project, so Project
Risk Management processes should be conducted iteratively. Risk is initially
addressed during project planning by shaping the project strategy. Risk should
also be monitored and managed as the project progresses to ensure that the
project stays on track and emergent risks are addressed.
In order to manage risk effectively on a particular project, the project team
needs to know what level of risk exposure is acceptable in pursuit of the project
objectives. This is defined by measurable risk thresholds that reflect the risk
appetite of the organization and project stakeholders. Risk thresholds express the
degree of acceptable variation around a project objective. They are explicitly
stated and communicated to the project team and reflected in the definitions of
risk impact levels for the project.
TRENDS AND EMERGING PRACTICES IN PROJECT RISK
MANAGEMENT
The focus of project risk management is broadening to ensure that all types of
risk are considered, and that project risks are understood in a wider context.
Trends and emerging practices for Project Risk Management include but are not
limited to:
Non-event risks. Most projects focus only on risks that are uncertain
future events that may or may not occur. Examples of event-based
risks include: a key seller may go out of business during the project,
the customer may change the requirement after design is complete, or
a subcontractor may propose enhancements to the standard operating
processes.
There is an increasing recognition that non-event risks need to be identified
and managed. There are two main types of non-event risks:
Variability risk. Uncertainty exists about some key characteristics of
a planned event or activity or decision. Examples of variability risks
include: productivity may be above or below target, the number of
errors found during testing may be higher or lower than expected, or
unseasonal weather conditions may occur during the construction
phase.
Ambiguity risk. Uncertainty exists about what might happen in the
future. Areas of the project where imperfect knowledge might affect
the project's ability to achieve its objectives include: elements of the
requirement or technical solution, future developments in regulatory
frameworks, or inherent systemic complexity in the project.
Variability risks can be addressed using Monte Carlo analysis, with the
range of variation reflected in probability distributions, followed by actions
to reduce the spread of possible outcomes. Ambiguity risks are managed by
defining those areas where there is a deficit of knowledge or understanding,
then filling the gap by obtaining expert external input or benchmarking
against best practices. Ambiguity is also addressed through incremental
development, prototyping, or simulation.
Project resilience. The existence of emergent risk is becoming clear,
with a growing awareness of so-called unknowable-unknowns. These
are risks that can only be recognized after they have occurred.
Emergent risks can be tackled through developing project resilience.
This requires each project to have:
Right level of budget and schedule contingency for emergent risks, in
addition to a specific risk budget for known risks;
Flexible project processes that can cope with emergent risk while
maintaining overall direction toward project goals, including strong
change management;
Empowered project team that has clear objectives and that is trusted
to get the job done within agreed-upon limits;
Frequent review of early warning signs to identify emergent risks as
early as possible; and
Clear input from stakeholders to clarify areas where the project scope
or strategy can be adjusted in response to emergent risks.
Integrated risk management. Projects exist in an organizational
context, and they may form part of a program or portfolio. Risk exists
at each of these levels, and risks should be owned and managed at the
appropriate level. Some risks identified at higher levels will be
delegated to the project team for management, and some project risks
may be escalated to higher levels if they are best managed outside the
project. A coordinated approach to enterprise-wide risk management
ensures alignment and coherence in the way risk is managed across all
levels. This builds risk efficiency into the structure of programs and
portfolios, providing the greatest overall value for a given level of risk
exposure.
TAILORING CONSIDERATIONS
Because each project is unique, it is necessary to tailor the way Project Risk
Management processes are applied. Considerations for tailoring include but are
not limited to:
Project size. Does the project's size in terms of budget, duration, scope,
or team size require a more detailed approach to risk management? Or
is it small enough to justify a simplified risk process?
Project complexity. Is a robust risk approach demanded by high levels
of innovation, new technology, commercial arrangements, interfaces,
or external dependencies that increase project complexity? Or is the
project simple enough that a reduced risk process will suffice?
Project importance. How strategically important is the project? Is the
level of risk increased for this project because it aims to produce
breakthrough opportunities, addresses significant blocks to
organizational performance, or involves major product innovation?
Development approach. Is this a waterfall project, where risk
processes can be followed sequentially and iteratively, or does the
project follow an agile approach where risk is addressed at the start of
each iteration as well as during its execution?
Tailoring of the Project Risk Management processes to meet these
considerations is part of the Plan Risk Management process, and the outcomes of
tailoring decisions are recorded in the risk management plan.
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
High-variability environments, by definition, incur more uncertainty and risk.
To address this, projects managed using adaptive approaches make use of
frequent reviews of incremental work products and cross-functional project
teams to accelerate knowledge sharing and ensure that risk is understood and
managed. Risk is considered when selecting the content of each iteration, and
risks will also be identified, analyzed, and managed during each iteration.
Additionally, the requirements are kept as a living document that is updated
regularly, and work may be reprioritized as the project progresses, based on an
improved understanding of current risk exposure.
11.1 PLAN RISK MANAGEMENT
Plan Risk Management is the process of defining how to conduct risk
management activities for a project. The key benefit of this process is that it
ensures that the degree, type, and visibility of risk management are proportionate
to both risks and the importance of the project to the organization and other
stakeholders. This process is performed once or at predefined points in the
project. The inputs, tools and techniques, and outputs of the process are depicted
in Figure 11-2. Figure 11-3 depicts the data flow diagram for the process.
The Plan Risk Management process should begin when a project is conceived
and should be completed early in the project. It may be necessary to revisit this
process later in the project life cycle, for example at a major phase change, or if
the project scope changes significantly, or if a subsequent review of risk
management effectiveness determines that the Project Risk Management process
requires modification.
11.1.1 PLAN RISK MANAGEMENT: INPUTS
11.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter documents the high-level
project description and boundaries, high-level requirements, and risks.
11.1.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. In planning Project Risk Management, all
approved subsidiary management plans should be taken into consideration in
order to make the risk management plan consistent with them. The methodology
outlined in other project management plan components might influence the Plan
Risk Management process.
11.1.1.3 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to the stakeholder register as described in Section 13.1.3.1. The
stakeholder register contains details of the project's stakeholders and provides an
overview of their project roles and their attitude toward risk on this project. This
is useful in determining roles and responsibilities for managing risk on the
project, as well as setting risk thresholds for the project.
11.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Risk
Management process include but are not limited to overall risk thresholds set by
the organization or key stakeholders.
11.1.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Risk
Management process include but are not limited to:
Organizational risk policy;
Risk categories, possibly organized into a risk breakdown structure;
Common definitions of risk concepts and terms;
Risk statement formats;
Templates for the risk management plan, risk register, and risk report;
Roles and responsibilities;
Authority levels for decision making; and
Lessons learned repository from previous similar projects.
11.1.2 PLAN RISK MANAGEMENT: TOOLS AND TECHNIQUES
11.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Familiarity with the organization's approach to managing risk,
including enterprise risk management where this is performed;
Tailoring risk management to the specific needs of a project; and
Types of risk that are likely to be encountered on projects in the same
area.
11.1.2.2 DATA ANALYSIS
Data analysis techniques that can be used for this process includes but are not
limited to a stakeholder analysis (Section 13.1.2.3) to determine the risk appetite
of project stakeholders.
11.1.2.3 MEETINGS
The risk management plan may be developed as part of the project kick-off
meeting or a specific planning meeting may be held. Attendees may include the
project manager, selected project team members, key stakeholders, or team
members who are responsible to manage the risk management process on the
project. Others outside the organization may also be invited, as needed,
including customers, sellers, and regulators. A skilled facilitator can help
participants remain focused on the task, agree on key aspects of the risk
approach, identify and overcome sources of bias, and resolve any disagreements
that may arise.
Plans for conducting risk management activities are defined in these meetings
and documented in the risk management plan (see Section 11.1.3.1).
11.1.3 PLAN RISK MANAGEMENT: OUTPUTS
11.1.3.1 RISK MANAGEMENT PLAN
The risk management plan is a component of the project management plan
that describes how risk management activities will be structured and performed.
The risk management plan may include some or all of the following elements:
Risk strategy. Describes the general approach to managing risk on this
project.
Methodology. Defines the specific approaches, tools, and data sources
that will be used to perform risk management on the project.
Roles and responsibilities. Defines the lead, support, and risk
management team members for each type of activity described in the
risk management plan, and clarifies their responsibilities.
Funding. Identifies the funds needed to perform activities related to
Project Risk Management. Establishes protocols for the application of
contingency and management reserves.
Timing. Defines when and how often the Project Risk Management
processes will be performed throughout the project life cycle, and
establishes risk management activities for inclusion into the project
schedule.
Risk categories. Provide a means for grouping individual project risks.
A common way to structure risk categories is with a risk breakdown
structure (RBS), which is a hierarchical representation of potential
sources of risk (see example in Figure 11-4). An RBS helps the project
team consider the full range of sources from which individual project
risks may arise. This can be useful when identifying risks or when
categorizing identified risks. The organization may have a generic
RBS to be used for all projects, or there may be several RBS
frameworks for different types of projects, or the project may develop
a tailored RBS. Where an RBS is not used, an organization may use a
custom risk categorization framework, which may take the form of a
simple list of categories or a structure based on project objectives.
Stakeholder risk appetite. The risk appetites of key stakeholders on the
project are recorded in the risk management plan, as they inform the
details of the Plan Risk Management process. In particular,
stakeholder risk appetite should be expressed as measurable risk
thresholds around each project objective. These thresholds will
determine the acceptable level of overall project risk exposure, and
they are also used to inform the definitions of probability and impacts
to be used when assessing and prioritizing individual project risks.
Definitions of risk probability and impacts. Definitions of risk
probability and impact levels are specific to the project context and
reflect the risk appetite and thresholds of the organization and key
stakeholders. The project may generate specific definitions of
probability and impact levels or it may start with general definitions
provided by the organization. The number of levels reflects the degree
of detail required for the Project Risk Management process, with more
levels used for a more detailed risk approach (typically five levels),
and fewer for a simple process (usually three). Table 11-1 provides an
example of definitions of probability and impacts against three project
objectives. These scales can be used to evaluate both threats and
opportunities by interpreting the impact definitions as negative for
threats (delay, additional cost, and performance shortfall) and positive
for opportunities (reduced time or cost, and performance
enhancement).
Probability and impact matrix. Described in Section 11.3.2.6.
Prioritization rules may be specified by the organization in advance of
the project and be included in organizational process assets, or they
may be tailored to the specific project. Opportunities and threats are
represented in a common probability and impact matrix using positive
definitions of impact for opportunities and negative impact definitions
for threats. Descriptive terms (such as very high, high, medium, low,
and very low) or numeric values can be used for probability and
impact. Where numeric values are used, these can be multiplied to
give a probability-impact score for each risk, which allows the relative
priority of individual risks to be evaluated within each priority level.
An example probability and impact matrix is presented in Figure 11-5,
which also shows a possible numeric risk scoring scheme.
Reporting formats. Reporting formats define how the outcomes of the
Project Risk Management process will be documented, analyzed, and
communicated. This section of the risk management plan describes the
content and format of the risk register and the risk report, as well as
any other required outputs from the Project Risk Management
processes.
Tracking. Tracking documents how risk activities will be recorded and
how risk management processes will be audited.
11.2 IDENTIFY RISKS
Identify Risks is the process of identifying individual project risks as well as
sources of overall project risk, and documenting their characteristics. The key
benefit of this process is the documentation of existing individual project risks
and the sources of overall project risk. It also brings together information so the
project team can respond appropriately to identified risks. This process is
performed throughout the project. The inputs, tools and techniques, and outputs
of the process are depicted in Figure 11-6. Figure 11-7 depicts the data flow
diagram for the process.
Identify Risks considers both individual project risks and sources of overall
project risk. Participants in risk identification activities may include the
following: project manager, project team members, project risk specialist (if
assigned), customers, subject matter experts from outside the project team, end
users, other project managers, operations managers, stakeholders, and risk
management experts within the organization. While these personnel are often
key participants for risk identification, all project stakeholders should be
encouraged to identify individual project risks. It is particularly important to
involve the project team so they can develop and maintain a sense of ownership
and responsibility for identified individual project risks, the level of overall
project risk, and associated risk response actions.
When describing and recording individual project risks, a consistent format
should be used for risk statements to ensure that each risk is understood clearly
and unambiguously in order to support effective analysis and risk response
development. Risk owners for individual project risks may be nominated as part
of the Identify Risks process, and will be confirmed during the Perform
Qualitative Risk Analysis process. Preliminary risk responses may also be
identified and recorded and will be reviewed and confirmed as part of the Plan
Risk Responses process.
Identify Risks is an iterative process, since new individual project risks may
emerge as the project progresses through its life cycle and the level of overall
project risk will also change. The frequency of iteration and participation in each
risk identification cycle will vary by situation, and this will be defined in the risk
management plan.
11.2.1 IDENTIFY RISKS: INPUTS
11.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan may indicate project objectives that are
particularly at risk.
Schedule management plan. Described in Section 6.1.3.1. The
schedule management plan may identify areas that are subject to
uncertainty or ambiguity.
Cost management plan. Described in Section 7.1.3.1. The cost
management plan may identify areas that are subject to uncertainty or
ambiguity.
Quality management plan. Described in Section 8.1.3.1. The quality
management plan may identify areas that are subject to uncertainty or
ambiguity, or where key assumptions have been made that might give
rise to risk.
Resource management plan. Described in Section 9.1.3.1. The
resource management plan may identify areas that are subject to
uncertainty or ambiguity, or where key assumptions have been made
that might give rise to risk.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan provides information on risk-related roles and
responsibilities, indicates how risk management activities are included
in the budget and schedule, and describes categories of risk, which
may be expressed as a risk breakdown structure (Figure 11-4).
Scope baseline. Described in Section 5.4.3.1. The scope baseline
includes deliverables and criteria for their acceptance, some of which
might give rise to risk. It also contains the WBS, which can be used as
a framework to structure risk identification techniques.
Schedule baseline. Described in Section 6.5.3.1. The schedule baseline
may be reviewed to identify milestones and deliverable due dates that
are subject to uncertainty or ambiguity, or where key assumptions
have been made that might give rise to risk.
Cost baseline. Described in Section 7.3.3.1. The cost baseline may be
reviewed to identify costs or funding requirements that are subject to
uncertainty or ambiguity, or where key assumptions have been made
that might give rise to risk.
11.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. Assumptions and
constraints recorded in the assumption log may give rise to individual
project risks and may also influence the level of overall project risk.
Cost estimates. Described in Section 7.2.3.1. Cost estimates provide
quantitative assessments of project costs, ideally expressed as a range,
indicating the degree of risk, where a structured review of the
documents may indicate that the current estimate is insufficient and
poses a risk to the project.
Duration estimates. Described in Section 6.4.3.1. Duration estimates
provide quantitative assessments of project durations, ideally
expressed as a range, indicating the degree of risk, where a structured
review of the documents may indicate that the current estimate is
insufficient and poses a risk to the project.
Issue log. Described in Section 4.3.3.3. Issues recorded in the issue log
may give rise to individual project risks and may also influence the
level of overall project risk.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
about risk identified from earlier phases of the project are reviewed to
determine whether similar risks might recur during the remainder of
the project.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation lists the project requirements and allows
the team to identify those that could be at risk.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements provide quantitative assessments of project resource
requirements, ideally expressed as a range, indicating the degree of
risk, where a structured review of the documents may indicate that the
current estimate is insufficient and poses a risk to the project.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register indicates which individuals or groups might participate in
identifying risks to the project. It also details those individuals who are
available to act as risk owners.
11.2.1.3 AGREEMENTS
Described in Section 12.2.3.2. If the project requires external procurement of
resources, the agreements may have information such as milestone dates,
contract type, acceptance criteria, and awards and penalties that can present
threats or opportunities.
11.2.1.4 PROCUREMENT DOCUMENTATION
Described in Section 12.3.1.4. If the project requires external procurement of
resources, the initial procurement documentation should be reviewed as
procuring goods and services from outside the organization may increase or
decrease overall project risk and may introduce additional individual project
risks. As the procurement documentation is updated throughout the project, the
most up to date documentation can be reviewed for risks. For example, seller
performance reports, approved change requests and information on inspections.
11.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Identify Risks
process include but are not limited to:
Published material, including commercial risk databases or checklists,
Academic studies,
Benchmarking results, and
Industry studies of similar projects.
11.2.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Identify Risks process
include but are not limited to:
Project files, including actual data,
Organizational and project process controls,
Risk statement formats, and
Checklists from previous similar projects.
11.2.2 IDENTIFY RISKS: TOOLS AND TECHNIQUES
11.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge of similar projects or business areas. Such
experts should be identified by the project manager and invited to consider all
aspects of individual project risks as well as sources of overall project risk, based
on their previous experience and areas of expertise. The experts’ bias should be
taken into account in this process.
11.2.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Brainstorming. The goal of brainstorming (see Section 4.1.2.2) is to
obtain a comprehensive list of individual project risks and sources of
overall project risk. The project team usually performs brainstorming,
often with a multidisciplinary set of experts who are not part of the
team. Ideas are generated under the guidance of a facilitator, either in a
free-form brainstorm session or one that uses more structured
techniques. Categories of risk, such as in a risk breakdown structure,
can be used as a framework. Particular attention should be paid to
ensuring that risks identified through brainstorming are clearly
described, since the technique can result in ideas that are not fully
formed.
Checklists. A checklist is a list of items, actions, or points to be
considered. It is often used as a reminder. Risk checklists are
developed based on historical information and knowledge that has
been accumulated from similar projects and from other sources of
information. They are an effective way to capture lessons learned from
similar completed projects, listing specific individual project risks that
have occurred previously and that may be relevant to this project. The
organization may maintain a risk checklist based on its own completed
projects or may use generic risk checklists from the industry. While a
checklist may be quick and simple to use, it is impossible to build an
exhaustive one, and care should be taken to ensure the checklist is not
used to avoid the effort of proper risk identification. The project team
should also explore items that do not appear on the checklist.
Additionally, the checklist should be reviewed from time to time to
update new information as well as remove or archive obsolete
information.
Interviews. Individual project risks and sources of overall project risk
can be identified by interviewing experienced project participants,
stakeholders, and subject matter experts. Interviews (see Section
5.2.2.2) should be conducted in an environment of trust and
confidentiality to encourage honest and unbiased contributions.
11.2.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Root cause analysis. Root cause analysis (see Section 8.2.2.2) is
typically used to discover the underlying causes that lead to a problem,
and develop preventive action. It can be used to identify threats by
starting with a problem statement (for example, the project might be
delayed or over budget) and exploring which threats might result in
that problem occurring. The same technique can be used to find
opportunities by starting with a benefit statement (for example, early
delivery or under budget) and exploring which opportunities might
result in that benefit being realized.
Assumption and constraint analysis. Every project and its project
management plan are conceived and developed based on a set of
assumptions and within a series of constraints. These are often already
incorporated in the scope baseline and project estimates. Assumption
and constraint analysis explores the validity of assumptions and
constraints to determine which pose a risk to the project. Threats may
be identified from the inaccuracy, instability, inconsistency, or
incompleteness of assumptions. Constraints may give rise to
opportunities through removing or relaxing a limiting factor that
affects the execution of a project or process.
SWOT analysis. This technique examines the project from each of the
strengths, weaknesses, opportunities, and threats (SWOT)
perspectives. For risk identification, it is used to increase the breadth
of identified risks by including internally generated risks. The
technique starts with the identification of strengths and weaknesses of
the organization, focusing on either the project, organization, or the
business area in general. SWOT analysis then identifies any
opportunities for the project that may arise from strengths, and any
threats resulting from weaknesses. The analysis also examines the
degree to which organizational strengths may offset threats and
determines if weaknesses might hinder opportunities.
Document analysis. Described in Section 5.2.2.3. Risks may be
identified from a structured review of project documents, including,
but not limited to, plans, assumptions, constraints, previous project
files, contracts, agreements, and technical documentation. Uncertainty
or ambiguity in project documents, as well as inconsistencies within a
document or between different documents, may be indicators of risk
on the project.
11.2.2.4 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process includes but are
not limited to facilitation (see Section 4.1.2.3). Facilitation improves the
effectiveness of many of the techniques used to identify individual project risks
and sources of overall project risk. A skilled facilitator can help participants
remain focused on the risk identification task, follow the method associated with
the technique accurately, ensure clear risk descriptions, identify and overcome
sources of bias, and resolve any disagreements that may arise.
11.2.2.5 PROMPT LISTS
A prompt list is a predetermined list of risk categories that might give rise to
individual project risks and that could also act as sources of overall project risk.
The prompt list can be used as a framework to aid the project team in idea
generation when using risk identification techniques. The risk categories in the
lowest level of the risk breakdown structure can be used as a prompt list for
individual project risks. Some common strategic frameworks are more suitable
for identifying sources of overall project risk, for example PESTLE (political,
economic, social, technological, legal, environmental), TECOP (technical,
environmental, commercial, operational, political), or VUCA (volatility,
uncertainty, complexity, ambiguity).
11.2.2.6 MEETINGS
To undertake risk identification, the project team may conduct a specialized
meeting (often called a risk workshop). Most risk workshops include some form
of brainstorming (see Section 4.1.2.2), but other risk identification techniques
may be included depending on the level of the risk process defined in the risk
management plan. Use of a skilled facilitator will increase the effectiveness of
the meeting. It is also essential to ensure that the right people participate in the
risk workshop. On larger projects, it may be appropriate to invite the project
sponsor, subject matter experts, sellers, representatives of the customer, or other
project stakeholders. Risk workshops for smaller projects may be restricted to a
subset of the project team.
11.2.3 IDENTIFY RISKS: OUTPUTS
11.2.3.1 RISK REGISTER
The risk register captures details of identified individual project risks. The
results of Perform Qualitative Risk Analysis, Plan Risk Responses, Implement
Risk Responses, and Monitor Risks are recorded in the risk register as those
processes are conducted throughout the project. The risk register may contain
limited or extensive risk information depending on project variables such as size
and complexity.
On completion of the Identify Risks process, the content of the risk register
may include but is not limited to:
List of identified risks. Each individual project risk is given a unique
identifier in the risk register. Identified risks are described in as much
detail as required to ensure unambiguous understanding. A structured
risk statement may be used to distinguish risks from their cause(s) and
their effect(s).
Potential risk owners. Where a potential risk owner has been identified
during the Identify Risks process, the risk owner is recorded in the risk
register. This will be confirmed during the Perform Qualitative Risk
Analysis process.
List of potential risk responses. Where a potential risk response has
been identified during the Identify Risks process, it is recorded in the
risk register. This will be confirmed during the Plan Risk Responses
process.
Additional data may be recorded for each identified risk, depending on the
risk register format specified in the risk management plan. This may include: a
short risk title, risk category, current risk status, one or more causes, one or more
effects on objectives, risk triggers (events or conditions that indicate that a risk is
about to occur), WBS reference of affected activities, and timing information
(when was the risk identified, when might the risk occur, when might it no
longer be relevant, and what is the deadline for taking action).
11.2.3.2 RISK REPORT
The risk report presents information on sources of overall project risk,
together with summary information on identified individual project risks. The
risk report is developed progressively throughout the Project Risk Management
process. The results of Perform Qualitative Risk Analysis, Perform Quantitative
Risk Analysis, Plan Risk Responses, Implement Risk Responses, and Monitor
Risks are also included in the risk report as those processes are completed. On
completion of the Identify Risks process, information in the risk report may
include but is not limited to:
Sources of overall project risk, indicating which are the most
important drivers of overall project risk exposure; and
Summary information on identified individual project risks, such as
number of identified threats and opportunities, distribution of risks
across risk categories, metrics and trends, etc.
Additional information may be included in the risk report, depending on the
reporting requirements specified in the risk management plan.
11.2.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. During the Identify
Risks process, new assumptions may be made, new constraints may be
identified, and existing assumptions or constraints may be revisited
and changed. The assumption log should be updated with this new
information.
Issue log. Described in Section 4.3.3.3. The issue log should be
updated to capture any new issues uncovered or changes in currently
logged issues.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with information on techniques that
were effective in identifying risks to improve performance in later
phases or other projects.
11.3 PERFORM QUALITATIVE RISK ANALYSIS
Perform Qualitative Risk Analysis is the process of prioritizing individual
project risks for further analysis or action by assessing their probability of
occurrence and impact as well as other characteristics. The key benefit of this
process is that it focuses efforts on high-priority risks. This process is performed
throughout the project. The inputs, tools and techniques, and outputs of the
process are depicted in Figure 11-8. Figure 11-9 depicts the data flow diagram
for the process.
Perform Qualitative Risk Analysis assesses the priority of identified
individual project risks using their probability of occurrence, the corresponding
impact on project objectives if the risks occur, and other factors. Such
assessments are subjective as they are based on perceptions of risk by the project
team and other stakeholders. Effective assessment therefore requires explicit
identification and management of the risk attitudes of key participants in the
Perform Qualitative Risk Analysis process. Risk perception introduces bias into
the assessment of identified risks, so attention should be paid to identifying bias
and correcting for it. Where a facilitator is used to support the Perform
Qualitative Risk Analysis process, addressing bias is a key part of the
facilitator's role. An evaluation of the quality of the available information on
individual project risks also helps to clarify the assessment of each risk's
importance to the project.
Perform Qualitative Risk Analysis establishes the relative priorities of
individual project risks for Plan Risk Responses. It identifies a risk owner for
each risk who will take responsibility for planning an appropriate risk response
and ensuring that it is implemented. Perform Qualitative Risk Analysis also lays
the foundation for Perform Quantitative Risk Analysis if this process is required.
The Perform Qualitative Risk Analysis process is performed regularly
throughout the project life cycle, as defined in the risk management plan. Often,
in an agile development environment, the Perform Qualitative Risk Analysis
process is conducted before the start of each iteration.
11.3.1 PERFORM QUALITATIVE RISK ANALYSIS: INPUTS
11.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
the risk management plan as described in Section 11.1.3.1. Of particular interest
in this process are the roles and responsibilities for conducting risk management,
budgets for risk management, schedule activities for risk management, risk
categories (often defined in a risk breakdown structure), definitions of
probability and impact, the probability and impact matrix, and stakeholders’ risk
thresholds. These inputs are usually tailored to the project during the Plan Risk
Management process. If they are not available, they may be developed during
the Perform Qualitative Risk Analysis process and presented to the project
sponsor for approval before use.
11.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log is
used for identifying, managing, and monitoring key assumptions and
constraints that may affect the project. These may inform the
assessment of the priority of individual project risks.
Risk register. Described in Section 11.2.3.1. The risk register contains
details of each identified individual project risk that will be assessed
during the Perform Qualitative Risk Analysis process.
Stakeholder register. Described in Section 13.1.3.1. This includes
details of project stakeholders who may be nominated as risk owners.
11.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence Perform Qualitative
Risk Analysis include but are not limited to:
Industry studies of similar projects, and
Published material, including commercial risk databases or checklists.
11.3.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence Perform Qualitative Risk
Analysis include but are not limited to information from similar completed
projects.
11.3.2 PERFORM QUALITATIVE RISK ANALYSIS: TOOLS
AND TECHNIQUES
11.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Previous similar projects, and
Qualitative risk analysis.
Expert judgment is often obtained through facilitated risk workshops or
interviews. The possibility of expert views being biased should be taken into
account in this process.
11.3.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to interviews. Structured or semi-structured interviews (Section 5.2.2.2)
can be used to assess the probability and impacts of individual project risks, as
well as other factors. The interviewer should promote an environment of trust
and confidentiality in the interview setting to encourage honest and unbiased
assessments.
11.3.2.3 DATA ANALYSIS
Data analysis techniques that can be used during this process include but are
not limited to:
Risk data quality assessment. Risk data quality assessment evaluates
the degree to which the data about individual project risks is accurate
and reliable as a basis for qualitative risk analysis. The use of low-
quality risk data may lead to a qualitative risk analysis that is of little
use to the project. If data quality is unacceptable, it may be necessary
to gather better data. Risk data quality may be assessed via a
questionnaire measuring the project's stakeholder perceptions of
various characteristics, which may include completeness, objectivity,
relevancy, and timeliness. A weighted average of selected data quality
characteristics can then be generated to give an overall quality score.
Risk probability and impact assessment. Risk probability assessment
considers the likelihood that a specific risk will occur. Risk impact
assessment considers the potential effect on one or more project
objectives such as schedule, cost, quality, or performance. Impacts will
be negative for threats and positive for opportunities. Probability and
impact are assessed for each identified individual project risk. Risks
can be assessed in interviews or meetings with participants selected for
their familiarity with the types of risk recorded in the risk register.
Project team members and knowledgeable persons external to the
project are included. The level of probability for each risk and its
impact on each objective are evaluated during the interview or
meeting. Differences in the levels of probability and impact perceived
by stakeholders are to be expected, and such differences should be
explored. Explanatory detail, including assumptions justifying the
levels assigned, are also recorded. Risk probabilities and impacts are
assessed using the definitions given in the risk management plan (see
Table 11-1). Risks with low probability and impact may be included
within the risk register as part of a watch list for future monitoring.
Assessment of other risk parameters. The project team may consider
other characteristics of risk (in addition to probability and impact)
when prioritizing individual project risks for further analysis and
action. These characteristics may include but are not limited to:
Urgency. The period of time within which a response to the risk is to
be implemented in order to be effective. A short period indicates high
urgency.
Proximity. The period of time before the risk might have an impact
on one or more project objectives. A short period indicates high
proximity.
Dormancy. The period of time that may elapse after a risk has
occurred before its impact is discovered. A short period indicates low
dormancy.
Manageability. The ease with which the risk owner (or owning
organization) can manage the occurrence or impact of a risk. Where
management is easy, manageability is high.
Controllability. The degree to which the risk owner (or owning
organization) is able to control the risk's outcome. Where the
outcome can be easily controlled, controllability is high.
Detectability. The ease with which the results of the risk occurring, or
being about to occur, can be detected and recognized. Where the risk
occurrence can be detected easily, detectability is high.
Connectivity. The extent to which the risk is related to other
individual project risks. Where a risk is connected to many other
risks, connectivity is high.
Strategic impact. The potential for the risk to have a positive or
negative effect on the organization's strategic goals. Where the risk
has a major effect on strategic goals, strategic impact is high.
Propinquity. The degree to which a risk is perceived to matter by one
or more stakeholders. Where a risk is perceived as very significant,
propinquity is high.
The consideration of some of these characteristics can provide a more robust
prioritization of risks than is possible by only assessing probability and impact.
11.3.2.4 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to facilitation (see Section 4.1.2.3). Facilitation improves the
effectiveness of the qualitative analysis of individual project risks. A skilled
facilitator can help participants remain focused on the risk analysis task, follow
the method associated with the technique accurately, reach consensus on
assessments of probability and impacts, identify and overcome sources of bias,
and resolve any disagreements that may arise.
11.3.2.5 RISK CATEGORIZATION
Risks to the project can be categorized by sources of risk (e.g., using the risk
breakdown structure (RBS); see Figure 11-4), the area of the project affected
(e.g., using the work breakdown structure (WBS); see Figures 5-12, 5-13, and 5-
14), or other useful categories (e.g., project phase, project budget, and roles and
responsibilities) to determine the areas of the project most exposed to the effects
of uncertainty. Risks can also be categorized by common root causes. Risk
categories that may be used for the project are defined in the risk management
plan.
Grouping risks into categories can lead to the development of more effective
risk responses by focusing attention and effort on the areas of highest risk
exposure, or by developing generic risk responses to address groups of related
risks.
11.3.2.6 DATA REPRESENTATION
Data representation techniques that can be used during this process include
but are not limited to:
Probability and impact matrix. A probability and impact matrix is a
grid for mapping the probability of each risk occurrence and its impact
on project objectives if that risk occurs. This matrix specifies
combinations of probability and impact that allow individual project
risks to be divided into priority groups (see Figure 11-5). Risks can be
prioritized for further analysis and planning of risk responses based on
their probability and impacts. The probability of occurrence for each
individual project risk is assessed as well as its impact on one or more
project objectives if it does occur, using definitions of probability and
impact for the project as specified in the risk management plan.
Individual project risks are assigned to a priority level based on the
combination of their assessed probability and impact, using a
probability and impact matrix.
An organization can assess a risk separately for each objective (e.g., cost,
time, and scope) by having a separate probability and impact matrix for
each. Alternatively, it may develop ways to determine one overall priority
level for each risk, either by combining assessments for different objectives,
or by taking the highest priority level regardless of which objective is
affected.
Hierarchical charts. Where risks have been categorized using more
than two parameters, the probability and impact matrix cannot be used
and other graphical representations are required. For example, a
bubble chart displays three dimensions of data, where each risk is
plotted as a disk (bubble), and the three parameters are represented by
the x-axis value, the y-axis value, and the bubble size. An example
bubble chart is shown in Figure 11-10, with detectability and
proximity plotted on the x and y axes, and impact value represented by
bubble size.
11.3.2.7 MEETINGS
To undertake qualitative risk analysis, the project team may conduct a
specialized meeting (often called a risk workshop) dedicated to the discussion of
identified individual project risks. The goals of this meeting include the review
of previously identified risks, assessment of probability and impacts (and
possibly other risk parameters), categorization, and prioritization. A risk owner,
who will be responsible for planning an appropriate risk response and for
reporting progress on managing the risk, will be allocated to each individual
project risk as part of the Perform Qualitative Risk Analysis process. The
meeting may start by reviewing and confirming the probability and impact scales
to be used for the analysis. The meeting may also identify additional risks during
the discussion, and these should be recorded for analysis. Use of a skilled
facilitator will increase the effectiveness of the meeting.
11.3.3 PERFORM QUALITATIVE RISK ANALYSIS: OUTPUTS
11.3.3.1 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. During the Perform
Qualitative Risk Analysis process, new assumptions may be made,
new constraints may be identified, and existing assumptions or
constraints may be revisited and changed. The assumption log should
be updated with this new information.
Issue log. Described in Section 4.3.3.3. The issue log should be
updated to capture any new issues uncovered or changes in currently
logged issues.
Risk register. Described in Section 11.2.3.1. The risk register is
updated with new information generated during the Perform
Qualitative Risk Analysis process. Updates to the risk register may
include assessments of probability and impacts for each individual
project risk, its priority level or risk score, the nominated risk owner,
risk urgency information or risk categorization, and a watch list for
low-priority risks or risks requiring further analysis.
Risk report. Described in Section 11.2.3.2. The risk report is updated
to reflect the most important individual project risks (usually those
with the highest probability and impact), as well as a prioritized list of
all identified risks on the project and a summary conclusion.
11.4 PERFORM QUANTITATIVE RISK ANALYSIS
Perform Quantitative Risk Analysis is the process of numerically analyzing
the combined effect of identified individual project risks and other sources of
uncertainty on overall project objectives. The key benefit of this process is that it
quantifies overall project risk exposure, and it can also provide additional
quantitative risk information to support risk response planning. This process is
not required for every project, but where it is used, it is performed throughout
the project. The inputs and outputs of this process are depicted in Figure 11-11.
Figure 11-12 depicts the data flow diagram for the process.
Perform Quantitative Risk Analysis is not required for all projects.
Undertaking a robust analysis depends on the availability of high-quality data
about individual project risks and other sources of uncertainty, as well as a sound
underlying project baseline for scope, schedule, and cost. Quantitative risk
analysis usually requires specialized risk software and expertise in the
development and interpretation of risk models. It also consumes additional time
and cost. The use of quantitative risk analysis for a project will be specified in
the project's risk management plan. It is most likely appropriate for large or
complex projects, strategically important projects, projects for which it is a
contractual requirement, or projects in which a key stakeholder requires it.
Quantitative risk analysis is the only reliable method to assess overall project
risk through evaluating the aggregated effect on project outcomes of all
individual project risks and other sources of uncertainty.
Perform Quantitative Risk Analysis uses information on individual project
risks that have been assessed by the Perform Qualitative Risk Analysis process
as having a significant potential to affect the project's objectives.
Outputs from Perform Quantitative Risk Analysis are used as inputs to the
Plan Risk Responses process, particularly in recommending responses to the
level of overall project risk and key individual risks. A quantitative risk analysis
may also be undertaken following the Plan Risk Responses process, to determine
the likely effectiveness of planned responses in reducing overall project risk
exposure.
11.4.1 PERFORM QUANTITATIVE RISK ANALYSIS: INPUTS
11.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Risk management plan. Described in Section 11.1.3.1. The risk
management plan specifies whether quantitative risk analysis is
required for the project. It also details the resources available for the
analysis and the expected frequency of analyses.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
describes the starting point from which the effect of individual project
risks and other sources of uncertainty are evaluated.
Schedule baseline. Described in Section 6.5.3.1. The schedule baseline
describes the starting point from which the effect of individual project
risks and other sources of uncertainty can be evaluated.
Cost baseline. Described in Section 7.3.3.1. The cost baseline
describes the starting point from which the effect of individual project
risks and other sources of uncertainty can be evaluated.
11.4.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. Assumptions may form
inputs to the quantitative risk analysis if they are assessed as posing a
risk to project objectives. The effect of constraints may also be
modeled during a quantitative risk analysis.
Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. The basis
of estimates used in the planning of the project may be reflected in
variability modeled during a quantitative risk analysis process. This
may include information on the estimate's purpose, classification,
assumed accuracy, methodology, and source.
Cost estimates. Described in Section 7.2.3.1. Cost estimates provide
the starting point from which cost variability is evaluated.
Cost forecasts. Described in Section 7.4.3.2. Forecasts such as the
project's estimate to complete (ETC), estimate at completion (EAC),
budget at completion (BAC), and to-complete performance index
(TCPI) may be compared to the results of a quantitative cost risk
analysis to determine the confidence level associated with achieving
these targets.
Duration estimates. Described in Section 6.4.3.1. Duration estimates
provide the starting point from which schedule variability is evaluated.
Milestone list. Described in Section 6.2.3.3. Significant events in the
project define the schedule targets against which the results of a
quantitative schedule risk analysis are compared, in order to determine
the confidence level associated with achieving these targets.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements provide the starting point from which variability is
evaluated.
Risk register. Described in Section 11.2.3.1. The risk register contains
details of individual project risks to be used as input for quantitative
risk analysis.
Risk report. Described in Section 11.2.3.2. The risk report describes
sources of overall project risk and the current overall project risk
status.
Schedule forecasts. Described in Section 6.6.3.2. Forecasts may be
compared to the results of a quantitative schedule risk analysis to
determine the confidence level associated with achieving these targets.
11.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Perform
Quantitative Risk Analysis process include but are not limited to:
Industry studies of similar projects, and
Published material, including commercial risk databases or checklists.
11.4.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Perform Quantitative
Risk Analysis process include information from similar completed projects.
11.4.2 PERFORM QUANTITATIVE RISK ANALYSIS: TOOLS
AND TECHNIQUES
11.4.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Translating information on individual project risks and other sources
of uncertainty into numeric inputs for the quantitative risk analysis
model,
Selecting the most appropriate representation of uncertainty to model
particular risks or other sources of uncertainty,
Modeling techniques that are appropriate in the context of the project,
Identifying which tools would be most suitable for the selected
modeling techniques, and
Interpreting the outputs of quantitative risk analysis.
11.4.2.2 DATA GATHERING
Interviews (see Section 5.2.2.2) may be used to generate inputs for the
quantitative risk analysis, drawing on inputs that include individual project risks
and other sources of uncertainty. This is particularly useful where information is
required from experts. The interviewer should promote an environment of trust
and confidentiality during the interview to encourage honest and unbiased
contributions.
11.4.2.3 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to facilitation (see Section 4.1.2.3). A skilled facilitator is useful for
gathering input data during a dedicated risk workshop involving project team
members and other stakeholders. Facilitated workshops can improve
effectiveness by establishing a clear understanding of the purpose of the
workshop, building consensus among participants, ensuring continued focus on
the task, and using creative approaches to deal with interpersonal conflict or
sources of bias.
11.4.2.4 REPRESENTATIONS OF UNCERTAINTY
Quantitative risk analysis requires inputs to a quantitative risk analysis model
that reflect individual project risks and other sources of uncertainty.
Where the duration, cost, or resource requirement for a planned activity is
uncertain, the range of possible values can be represented in the model as a
probability distribution. This may take several forms. The most commonly used
are triangular, normal, lognormal, beta, uniform, or discrete distributions. Care
should be taken when selecting an appropriate probability distribution to reflect
the range of possible values for the planned activity.
Individual project risks may be covered by probability distributions.
Alternatively, risks may be included in the model as probabilistic branches,
where optional activities are added to the model to represent the time and/or cost
impact of the risk should it occur, and the chance that these activities actually
occur in a particular simulation run matches the risk's probability. Branches are
most useful for risks that might occur independently of any planned activity.
Where risks are related, for example, with a common cause or a logical
dependency, correlation is used in the model to indicate this relationship.
Other sources of uncertainty may also be represented using branches to
describe alternative paths through the project.
11.4.2.5 DATA ANALYSIS
Data analysis techniques that can be used during this process include but are
not limited to:
Simulation. Quantitative risk analysis uses a model that simulates the
combined effects of individual project risks and other sources of
uncertainty to evaluate their potential impact on achieving project
objectives. Simulations are typically performed using a Monte Carlo
analysis. When running a Monte Carlo analysis for cost risk, the
simulation uses the project cost estimates. When running a Monte
Carlo analysis for schedule risk, the schedule network diagram and
duration estimates are used. An integrated quantitative cost-schedule
risk analysis uses both inputs. The output is a quantitative risk analysis
model.
Computer software is used to iterate the quantitative risk analysis model
several thousand times. The input values (e.g., cost estimates, duration
estimates, or occurrence of probabilistic branches) are chosen at random for
each iteration. Outputs represent the range of possible outcomes for the
project (e.g., project end date, project cost at completion). Typical outputs
include a histogram presenting the number of iterations where a particular
outcome resulted from the simulation, or a cumulative probability
distribution (S-curve) representing the probability of achieving any
particular outcome or less. An example S-curve from a Monte Carlo cost
risk analysis is shown in Figure 11-13.
For a quantitative schedule risk analysis, it is also possible to conduct a
criticality analysis that determines which elements of the risk model have
the greatest effect on the project critical path. A criticality index is
calculated for each element in the risk model, which gives the frequency
with which that element appears on the critical path during the simulation,
usually expressed as a percentage. The output from a criticality analysis
allows the project team to focus risk response planning efforts on those
activities with the highest potential effect on the overall schedule
performance of the project.
Sensitivity analysis. Sensitivity analysis helps to determine which
individual project risks or other sources of uncertainty have the most
potential impact on project outcomes. It correlates variations in project
outcomes with variations in elements of the quantitative risk analysis
model.
One typical display of sensitivity analysis is the tornado diagram, which
presents the calculated correlation coefficient for each element of the
quantitative risk analysis model that can influence the project outcome.
This can include individual project risks, project activities with high
degrees of variability, or specific sources of ambiguity. Items are ordered
by descending strength of correlation, giving the typical tornado
appearance. An example tornado diagram is shown in Figure 11-14.
Decision tree analysis. Decision trees are used to support selection of
the best of several alternative courses of action. Alternative paths
through the project are shown in the decision tree using branches
representing different decisions or events, each of which can have
associated costs and related individual project risks (including both
threats and opportunities). The end-points of branches in the decision
tree represent the outcome from following that particular path, which
can be negative or positive.
The decision tree is evaluated by calculating the expected monetary value
of each branch, allowing the optimal path to be selected. An example
decision tree is shown in Figure 11-15.
Influence diagrams. Influence diagrams are graphical aids to decision
making under uncertainty. An influence diagram represents a project
or situation within the project as a set of entities, outcomes, and
influences, together with the relationships and effects between them.
Where an element in the influence diagram is uncertain as a result of
the existence of individual project risks or other sources of uncertainty,
this can be represented in the influence diagram using ranges or
probability distributions. The influence diagram is then evaluated
using a simulation technique, such as Monte Carlo analysis, to indicate
which elements have the greatest influence on key outcomes. Outputs
from an influence diagram are similar to other quantitative risk
analysis methods, including S-curves and tornado diagrams.
11.4.3 PERFORM QUANTITATIVE RISK ANALYSIS: OUTPUTS
11.4.3.1 PROJECT DOCUMENTS UPDATES
Project documents that can be considered as outputs for this process include
but are not limited to the risk report described in Section 11.2.3.2. The risk
report will be updated to reflect the results of the quantitative risk analysis. This
will typically include:
Assessment of overall project risk exposure. Overall project risk is
reflected in two key measures:
Chances of project success, indicated by the probability that the
project will achieve its key objectives (e.g., required end date or
interim milestones, required cost target, etc.) given the identified
individual project risks and other sources of uncertainty; and
Degree of inherent variability remaining within the project at the time
the analysis was conducted, indicated by the range of possible project
outcomes.
Detailed probabilistic analysis of the project. Key outputs from the
quantitative risk analysis are presented, such as S-curves, tornado
diagrams, and criticality analysis, together with a narrative
interpretation of the results. Possible detailed results of a quantitative
risk analysis may include:
Amount of contingency reserve needed to provide a specified level of
confidence;
Identification of individual project risks or other sources of
uncertainty that have the greatest effect on the project critical path;
and
Major drivers of overall project risk, with the greatest influence on
uncertainty in project outcomes.
Prioritized list of individual project risks. This list includes those
individual project risks that pose the greatest threat or present the
greatest opportunity to the project, as indicated by sensitivity analysis.
Trends in quantitative risk analysis results. As the analysis is repeated
at different times during the project life cycle, trends may become
apparent that inform the planning of risk responses.
Recommended risk responses. The risk report may present suggested
responses to the level of overall project risk exposure or key individual
project risks, based on the results of the quantitative risk analysis.
These recommendations will form inputs to the Plan Risk Responses
process.
11.5 PLAN RISK RESPONSES
Plan Risk Responses is the process of developing options, selecting strategies,
and agreeing on actions to address overall project risk exposure, as well as to
treat individual project risks. The key benefit of this process is that it identifies
appropriate ways to address overall project risk and individual project risks. This
process also allocates resources and inserts activities into project documents and
the project management plan as needed. This process is performed throughout
the project. The inputs, tools and techniques, and outputs of the process are
depicted in Figure 11-16. Figure 11-17 depicts the data flow diagram for the
process.
Effective and appropriate risk responses can minimize individual threats,
maximize individual opportunities, and reduce overall project risk exposure.
Unsuitable risk responses can have the converse effect. Once risks have been
identified, analyzed, and prioritized, plans should be developed by the
nominated risk owner for addressing every individual project risk the project
team considers to be sufficiently important, either because of the threat it poses
to the project objectives or the opportunity it offers. The project manager should
also consider how to respond appropriately to the current level of overall project
risk.
Risk responses should be appropriate for the significance of the risk, cost-
effective in meeting the challenge, realistic within the project context, agreed
upon by all parties involved, and owned by a responsible person. Selecting the
optimal risk response from several options is often required. The strategy or mix
of strategies most likely to be effective should be selected for each risk.
Structured decision-making techniques may be used to choose the most
appropriate response. For large or complex projects, it may be appropriate to use
a mathematical optimization model or real options analysis as a basis for a more
robust economic analysis of alternative risk response strategies.
Specific actions are developed to implement the agreed-upon risk response
strategy, including primary and backup strategies, as necessary. A contingency
plan (or fallback plan) can be developed for implementation if the selected
strategy turns out not to be fully effective or if an accepted risk occurs.
Secondary risks should also be identified. Secondary risks are risks that arise as
a direct result of implementing a risk response. A contingency reserve is often
allocated for time or cost. If developed, it may include identification of the
conditions that trigger its use.
11.5.1 PLAN RISK RESPONSES: INPUTS
11.5.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan is used to help determine how resources
allocated to agreed-upon risk responses will be coordinated with other
project resources.
Risk management plan. Described in Section 11.1.3.1. Risk
management roles and responsibilities and risk thresholds are used in
this process.
Cost baseline. Described in Section 7.3.3.1. The cost baseline has
information on the contingency fund that is allocated to respond to
risks.
11.5.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
about effective risk responses used in earlier phases of the project are
reviewed to determine if similar responses might be useful during the
remainder of the project.
Project schedule. Described in Section 6.5.3.2. The schedule is used to
determine how agreed-upon risk responses will be scheduled alongside
other project activities.
Project team assignments. Described in Section 9.3.3.2. Project team
assignments can show the resources that can be allocated to agreed-
upon risk responses.
Resource calendars. Described in Section 9.2.1.2. Resource calendars
identify when potential resources are available to be allocated to
agreed-upon risk responses.
Risk register. Described in Section 11.2.3.1. The risk register contains
details of individual project risks that have been identified and
prioritized, and for which risk responses are required. The priority
level for each risk can help to guide the selection of appropriate risk
responses. For example, high-priority threats or opportunities may
require priority action and highly proactive response strategies.
Threats and opportunities in the low-priority zone may not require
proactive management action beyond being placed in the risk register
as part of the watch list or adding a contingency reserve.
The risk register identifies the nominated risk owner for each risk. It may
also contain preliminary risk responses identified earlier in the Project Risk
Management process. The risk register may provide other data on identified
risks that can assist in planning risk responses, including root causes, risk
triggers and warning signs, risks requiring responses in the near term, and
risks where a need for additional analysis has been identified.
Risk report. Described in Section 11.2.3.2. The risk report presents the
current level of overall risk exposure of the project that will inform
selection of the risk response strategy. The risk report may also list
individual project risks in priority order and provide additional
analysis of the distribution of individual project risks that may inform
risk response selection.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register identifies potential owners for risk responses.
11.5.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Risk
Responses process include but are not limited to the risk appetite and thresholds
of key stakeholders.
11.5.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Risk Responses
process include but are not limited to:
Templates for the risk management plan, risk register, and risk report;
Historical databases; and
Lessons learned repositories from similar projects.
11.5.2 PLAN RISK RESPONSES: TOOLS AND TECHNIQUES
11.5.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge in the following topics:
Threat response strategies,
Opportunity response strategies,
Contingent response strategies, and
Overall project risk response strategies.
Expert input may be sought from individuals with particular subject matter
expertise relevant to a specific individual project risk, for example, where
specialist technical knowledge is required.
11.5.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to interviews (see Section 5.2.2.2). Development of responses to
individual project risks and overall project risk may be undertaken during
structured or semi-structured interviews (see Section 5.2.2.2) with risk owners.
Other stakeholders may also be interviewed if necessary. The interviewer should
promote an environment of trust and confidentiality in the interview setting to
encourage honest and unbiased decisions.
11.5.2.3 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process includes but are
not limited to facilitation (see Section 4.1.2.3). The use of facilitation improves
the effectiveness of developing responses to individual project risks and overall
project risk. A skilled facilitator can help risk owners understand the risk,
identify and compare alternative possible risk response strategies, choose an
appropriate response strategy, and identify and overcome sources of bias.
11.5.2.4 STRATEGIES FOR THREATS
Five alternative strategies may be considered for dealing with threats, as
follows:
Escalate. Escalation is appropriate when the project team or the project
sponsor agrees that a threat is outside the scope of the project or that
the proposed response would exceed the project manager's authority.
Escalated risks are managed at the program level, portfolio level, or
other relevant part of the organization, and not on the project level.
The project manager determines who should be notified about the
threat and communicates the details to that person or part of the
organization. It is important that ownership of escalated threats is
accepted by the relevant party in the organization. Threats are usually
escalated to the level that matches the objectives that would be
affected if the threat occurred. Escalated threats are not monitored
further by the project team after escalation, although they may be
recorded in the risk register for information.
Avoid. Risk avoidance is when the project team acts to eliminate the
threat or protect the project from its impact. It may be appropriate for
high-priority threats with a high probability of occurrence and a large
negative impact. Avoidance may involve changing some aspect of the
project management plan or changing the objective that is in jeopardy
in order to eliminate the threat entirely, reducing its probability of
occurrence to zero. The risk owner may also take action to isolate the
project objectives from the risk's impact if it were to occur. Examples
of avoidance actions may include removing the cause of a threat,
extending the schedule, changing the project strategy, or reducing
scope. Some risks can be avoided by clarifying requirements,
obtaining information, improving communication, or acquiring
expertise.
Transfer. Transfer involves shifting ownership of a threat to a third
party to manage the risk and to bear the impact if the threat occurs.
Risk transfer often involves payment of a risk premium to the party
taking on the threat. Transfer can be achieved by a range of actions,
which include but are not limited to the use of insurance, performance
bonds, warranties, guarantees, etc. Agreements may be used to transfer
ownership and liability for specified risks to another party.
Mitigate. In risk mitigation, action is taken to reduce the probability of
occurrence and/or impact of a threat. Early mitigation action is often
more effective than trying to repair the damage after the threat has
occurred. Adopting less complex processes, conducting more tests, or
choosing a more stable seller are examples of mitigation actions.
Mitigation may involve prototype development (see Section 5.2.2.8) to
reduce the risk of scaling up from a bench-scale model of a process or
product. Where it is not possible to reduce probability, a mitigation
response might reduce the impact by targeting factors that drive the
severity. For example, designing redundancy into a system may reduce
the impact from a failure of the original component.
Accept. Risk acceptance acknowledges the existence of a threat, but no
proactive action is taken. This strategy may be appropriate for low-
priority threats, and it may also be adopted where it is not possible or
cost-effective to address a threat in any other way. Acceptance can be
either active or passive. The most common active acceptance strategy
is to establish a contingency reserve, including amounts of time,
money, or resources to handle the threat if it occurs. Passive
acceptance involves no proactive action apart from periodic review of
the threat to ensure that it does not change significantly.
11.5.2.5 STRATEGIES FOR OPPORTUNITIES
Five alternative strategies may be considered for dealing with opportunities,
as follows:
Escalate. This risk response strategy is appropriate when the project
team or the project sponsor agrees that an opportunity is outside the
scope of the project or that the proposed response would exceed the
project manager's authority. Escalated opportunities are managed at
the program level, portfolio level, or other relevant part of the
organization, and not on the project level. The project manager
determines who should be notified about the opportunity and
communicates the details to that person or part of the organization. It
is important that ownership of escalated opportunities is accepted by
the relevant party in the organization. Opportunities are usually
escalated to the level that matches the objectives that would be
affected if the opportunity occurred. Escalated opportunities are not
monitored further by the project team after escalation, although they
may be recorded in the risk register for information.
Exploit. The exploit strategy may be selected for high-priority
opportunities where the organization wants to ensure that the
opportunity is realized. This strategy seeks to capture the benefit
associated with a particular opportunity by ensuring that it definitely
happens, increasing the probability of occurrence to 100%. Examples
of exploiting responses may include assigning an organization's most
talented resources to the project to reduce the time to completion, or
using new technologies or technology upgrades to reduce cost and
duration.
Share. Sharing involves transferring ownership of an opportunity to a
third party so that it shares some of the benefit if the opportunity
occurs. It is important to select the new owner of a shared opportunity
carefully so they are best able to capture the opportunity for the benefit
of the project. Risk sharing often involves payment of a risk premium
to the party taking on the opportunity. Examples of sharing actions
include forming risk-sharing partnerships, teams, special-purpose
companies, or joint ventures.
Enhance. The enhance strategy is used to increase the probability
and/or impact of an opportunity. Early enhancement action is often
more effective than trying to improve the benefit after the opportunity
has occurred. The probability of occurrence of an opportunity may be
increased by focusing attention on its causes. Where it is not possible
to increase probability, an enhancement response might increase the
impact by targeting factors that drive the size of the potential benefit.
Examples of enhancing opportunities include adding more resources to
an activity to finish early.
Accept. Accepting an opportunity acknowledges its existence but no
proactive action is taken. This strategy may be appropriate for low-
priority opportunities, and it may also be adopted where it is not
possible or cost-effective to address an opportunity in any other way.
Acceptance can be either active or passive. The most common active
acceptance strategy is to establish a contingency reserve, including
amounts of time, money, or resources to take advantage of the
opportunity if it occurs. Passive acceptance involves no proactive
action apart from periodic review of the opportunity to ensure that it
does not change significantly.
11.5.2.6 CONTINGENT RESPONSE STRATEGIES
Some responses are designed for use only if certain events occur. For some
risks, it is appropriate for the project team to make a response plan that will only
be executed under certain predefined conditions, if it is believed that there will
be sufficient warning to implement the plan. Events that trigger the contingency
response, such as missing intermediate milestones or gaining higher priority with
a seller, should be defined and tracked. Risk responses identified using this
technique are often called contingency plans or fallback plans and include
identified triggering events that set the plans in effect.
11.5.2.7 STRATEGIES FOR OVERALL PROJECT RISK
Risk responses should be planned and implemented not only for individual
project risks but also to address overall project risk. The same risk response
strategies that are used to deal with individual project risks can also be applied to
overall project risk:
Avoid. Where the level of overall project risk is significantly negative
and outside the agreed-upon risk thresholds for the project, an avoid
strategy may be adopted. This involves taking focused action to reduce
the negative effect of uncertainty on the project as a whole and bring
the project back within the thresholds. An example of avoidance at the
overall project level would include removal of high-risk elements of
scope from the project. Where it is not possible to bring the project
back within the thresholds, the project may be canceled. This
represents the most extreme degree of risk avoidance and it should be
used only if the overall level of threat is, and will remain,
unacceptable.
Exploit. Where the level of overall project risk is significantly positive
and outside the agreed-upon risk thresholds for the project, an exploit
strategy may be adopted. This involves taking focused action to
capture the positive effect of uncertainty on the project as a whole. An
example of exploiting at the overall project level would include
addition of high-benefit elements of scope to the project to add value
or benefits to stakeholders. Alternatively the risk thresholds for the
project may be modified with the agreement of key stakeholders in
order to embrace the opportunity.
Transfer/share. If the level of overall project risk is high but the
organization is unable to address it effectively, a third party may be
involved to manage the risk on behalf of the organization. Where
overall project risk is negative, a transfer strategy is required, which
may involve payment of a risk premium. In the case of high positive
overall project risk, ownership may be shared in order to reap the
associated benefits. Examples of both transfer and share strategies for
overall project risk include but are not limited to setting up a
collaborative business structure in which the buyer and the seller share
the overall project risk, launching a joint venture or special-purpose
company, or subcontracting key elements of the project.
Mitigate/enhance. These strategies involve changing the level of
overall project risk to optimize the chances of achieving the project's
objectives. The mitigation strategy is used where overall project risk is
negative, and enhancement applies when it is positive. Examples of
mitigation or enhancement strategies include replanning the project,
changing the scope and boundaries of the project, modifying project
priority, changing resource allocations, adjusting delivery times, etc.
Accept. Where no proactive risk response strategy is possible to
address overall project risk, the organization may choose to continue
with the project as currently defined, even if overall project risk is
outside the agreed-upon thresholds. Acceptance can be either active or
passive. The most common active acceptance strategy is to establish
an overall contingency reserve for the project, including amounts of
time, money, or resources to be used if the project exceeds its
thresholds. Passive acceptance involves no proactive action apart from
periodic review of the level of overall project risk to ensure that it does
not change significantly.
11.5.2.8 DATA ANALYSIS
A number of alternative risk response strategies may be considered. Data
analysis techniques that can be used to select a preferred risk response strategy
include but are not limited to:
Alternatives analysis. A simple comparison of the characteristics and
requirements of alternative risk response options can lead to a decision
on which response is most appropriate.
Cost-benefit analysis. If the impact of an individual project risk can be
quantified in monetary terms, then the cost-effectiveness of alternative
risk response strategies can be determined using cost-benefit analysis
(see Section 8.1.2.3). The ratio of (change in impact level) divided by
(implementation cost) gives the cost effectiveness of the response
strategy, with a higher ratio indicating a more effective response.
11.5.2.9 DECISION MAKING
Decision-making techniques that can be used to select a risk response strategy
include but are not limited to multicriteria decision analysis (described in
Section 8.1.2.4). One or more risk response strategies may be under
consideration. Decision-making techniques can help prioritize risk response
strategies. Multicriteria decision analysis uses a decision matrix to provide a
systematic approach for establishing key decision criteria, evaluating and
ranking alternatives, and selecting a preferred option. Criteria for risk response
selection may include but are not limited to cost of response, likely effectiveness
of response in changing probability and/or impact, resource availability, timing
constraints (urgency, proximity, and dormancy), level of impact if the risk
occurs, effect of response on related risks, introduction of secondary risks, etc.
Different strategies may be selected later in the project if the original choice
proves to be ineffective.
11.5.3 PLAN RISK RESPONSES: OUTPUTS
11.5.3.1 CHANGE REQUESTS
Described in Section 4.3.3.4. Planned risk responses may result in a change
request to the cost and schedule baselines or other components of the project
management plan. Change requests are processed for review and disposition
through the Perform Integrated Change Control process (Section 4.6).
11.5.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Schedule management plan. Described in Section 6.1.3.1. Changes to
the schedule management plan, such as changes to resource loading
and leveling, or updates to the schedule strategy, are incorporated.
Cost management plan. Described in Section 7.1.3.1. Changes to the
cost management plan, such as changes to cost accounting, tracking,
and reports, as well as updates to the budget strategy and how
contingency reserves are consumed, are incorporated.
Quality management plan. Described in Section 8.1.3.1. Changes to
the quality management plan, such as changes to approaches for
meeting requirements, quality management approaches, or quality
control processes, are incorporated.
Resource management plan. Described in Section 9.1.3.1. Changes to
the resource management plan, such as changes to resource allocation,
as well as updates to the resource strategy, are incorporated.
Procurement management plan. Described in Section 12.1.3.1.
Changes to the procurement management plan, such as alterations in
the make-or-buy decision or contract type(s), are incorporated.
Scope baseline. Described in Section 5.4.3.1. Changes in the scope
baseline are incorporated in response to approved changes in scope
that may arise from agreed-upon risk responses.
Schedule baseline. Described in Section 6.5.3.1. Changes in the
schedule baseline are incorporated in response to approved changes in
schedule estimates that may arise from agreed-upon risk responses.
Cost baseline. Described in Section 7.3.3.1. Changes in the cost
baseline are incorporated in response to approved changes in cost
estimates that may arise from agreed-upon risk responses.
11.5.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. During the Plan Risk
Responses process, new assumptions may be made, new constraints
may be identified, and existing assumptions or constraints may be
revisited and changed. The assumption log should be updated with this
new information.
Cost forecasts. Described in Section 7.4.3.2. Cost forecasts may
change as a result of planned risk responses.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information about risk responses that
may be useful for future phases of the project or future projects.
Project schedule. Described in Section 6.5.3.2. Activities relating to
agreed-upon risk responses may be added to the project schedule.
Project team assignments. Described in Section 9.3.3.2. Once the
responses are confirmed, the necessary resources should be allocated
to each action associated with a risk response plan. These resources
include suitably qualified and experienced personnel to execute the
agreed-upon action (usually within the project team) a specific budget
and time allowance for the action, and any required technical resources
to complete the action.
Risk register. Described in Section 11.2.3.1. The risk register is
updated when appropriate risk responses are chosen and agreed upon.
Updates to the risk register may include but are not limited to:
Agreed-upon response strategies;
Specific actions to implement the chosen response strategy;
Trigger conditions, symptoms, and warning signs of a risk
occurrence;
Budget and schedule activities required to implement the chosen
responses;
Contingency plans and risk triggers that call for their execution;
Fallback plans for use when a risk that has occurred and the primary
response proves to be inadequate;
Residual risks that are expected to remain after planned responses
have been taken, as well as those that have been deliberately
accepted; and
Secondary risks that arise as a direct outcome of implementing a risk
response.
Risk report. Described in Section 11.2.3.2. The risk report may be
updated to present agreed-upon responses to the current overall project
risk exposure and high-priority risks, together with the expected
changes that may be expected as a result of implementing these
responses.
11.6 IMPLEMENT RISK RESPONSES
Implement Risk Responses is the process of implementing agreed-upon risk
response plans. The key benefit of this process is that it ensures that agreed-upon
risk responses are executed as planned in order to address overall project risk
exposure, minimize individual project threats, and maximize individual project
opportunities. This process is performed throughout the project. The inputs, tools
and techniques, and outputs of the process are depicted in Figure 11-18. Figure
11-19 depicts the data flow diagram for the process.
Proper attention to the Implement Risk Responses process will ensure that
agreed-upon risk responses are actually executed. A common problem with
Project Risk Management is that project teams spend effort in identifying and
analyzing risks and developing risk responses, then risk responses are agreed
upon and documented in the risk register and risk report, but no action is taken to
manage the risk.
Only if risk owners give the required level of effort to implementing the
agreed-upon responses will the overall risk exposure of the project and
individual threats and opportunities be managed proactively.
11.6.1 IMPLEMENT RISK RESPONSES: INPUTS
11.6.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the risk management plan. Described in Section 11.1.3.1,
the risk management plan lists the roles and responsibilities of project team
members and other stakeholders for risk management. This information is used
when allocating owners for agreed-upon risk responses. The risk management
plan also defines the level of detail for the risk management methodology for the
project. It also specifies risk thresholds for the project based on the risk appetite
of key stakeholders, which define the acceptable target that the implementation
of risk responses is required to achieve.
11.6.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to implementing risk responses can be
applied to later phases in the project to improve the effectiveness of
this process.
Risk register. Described in Section 11.2.3.1. The risk register records
the agreed-upon risk responses for each individual risk and the
nominated owners for each response plan.
Risk report. Described in Section 11.2.3.2. The risk report includes an
assessment of the current overall project risk exposure, as well as the
agreed-upon risk response strategy. It also describes the major
individual project risks with their planned responses.
11.6.1.3 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Implement Risk
Responses process include but are not limited to the lessons learned repository
from similar completed projects that indicate the effectiveness of particular risk
responses.
11.6.2 IMPLEMENT RISK RESPONSES: TOOLS AND
TECHNIQUES
11.6.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge to validate or modify risk responses if
necessary, and decide how to implement them in the most efficient and effective
manner.
11.6.2.2 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to influencing. Some risk response actions may be owned by people
outside the immediate project team or who have other competing demands. The
project manager or person responsible for facilitating the risk process may need
to exercise influencing (see Section 9.5.2.1) to encourage nominated risk owners
to take necessary action where required.
11.6.2.3 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS)
Described in Section 4.3.2.2. Project management information systems can
include schedule, resource, and cost software to ensure that agreed-upon risk
response plans and their associated activities are integrated into the project
alongside other project activities.
11.6.3 IMPLEMENT RISK RESPONSES: OUTPUTS
11.6.3.1 CHANGE REQUESTS
Described in Section 4.3.3.4. Implementation of risk responses may result in a
change request to the cost and schedule baselines or other components of the
project management plan. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
11.6.3.2 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. Where issues are identified as
part of the Implement Risk Responses process, they are recorded in the
issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
when implementing risk responses and how they could have been
avoided, as well as approaches that worked well for implementing risk
responses.
Project team assignments. Described in Section 9.3.3.2. Once the risk
responses are confirmed, the necessary resources should be allocated
to each action associated with a risk response plan. These resources
include suitably qualified and experienced personnel to execute the
agreed-upon action (usually within the project team), a specific budget
and time allowance for the action, and any required technical resources
to complete the action.
Risk register. Described in Section 11.2.3.1. The risk register may be
updated to reflect any changes to the previously agreed-upon risk
responses for individual project risks that are subsequently made as a
result of the Implement Risk Responses process.
Risk report. Described in Section 11.2.3.2. The risk report may be
updated to reflect any changes to the previously agreed-upon risk
response to overall project risk exposure that are subsequently made as
a result of the Implement Risk Responses process.
11.7 MONITOR RISKS
Monitor Risks is the process of monitoring the implementation of agreed-upon
risk response plans, tracking identified risks, identifying and analyzing new
risks, and evaluating risk process effectiveness throughout the project. The key
benefit of this process is that it enables project decisions to be based on current
information about overall project risk exposure and individual project risks. This
process is performed throughout the project. The inputs, tools and techniques,
and outputs of the process are depicted in Figure 11-20. Figure 11-21 depicts the
data flow diagram for the process.
In order to ensure that the project team and key stakeholders are aware of the
current level of risk exposure, project work should be continuously monitored
for new, changing, and outdated individual project risks and for changes in the
level of overall project risk by applying the Monitor Risks process. The Monitor
Risks process uses performance information generated during project execution
to determine if:
Implemented risk responses are effective,
Level of overall project risk has changed,
Status of identified individual project risks has changed,
New individual project risks have arisen,
Risk management approach is still appropriate,
Project assumptions are still valid,
Risk management policies and procedures are being followed,
Contingency reserves for cost or schedule require modification, and
Project strategy is still valid.
11.7.1 MONITOR RISKS: INPUTS
11.7.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to the risk management plan. Described in Section 11.3.1.1.
The risk management plan provides guidance on how and when risks should be
reviewed, which policies and procedures should be followed, the roles and
responsibilities in the monitoring process, and reporting formats.
11.7.1.2 PROJECT DOCUMENTS
Project documents that should be considered as inputs for this process include
but are not limited to:
Issue log. Described in Section 4.3.3.3. The issue log is used to see if
any of the open issues have been updated and necessitate an update to
the risk register.
Lessons learned register. Described in Section 4.4.3.1. Risk-related
lessons from earlier in the project can be applied to later phases in the
project.
Risk register. Described in Section 11.2.3.1. The risk register has key
inputs that include identified individual project risks, risk owners,
agreed-upon risk responses, and specific implementation actions. It
may also provide other details including control actions for assessing
the effectiveness of response plans, symptoms and warning signs of
risk, residual and secondary risks, and a watch list of low-priority
risks.
Risk report. Described in Section 11.2.3.2. The risk report includes an
assessment of the current overall project risk exposure as well as the
agreed-upon risk response strategy. It also describes the major
individual risks with planned responses and risk owners.
11.7.1.3 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on project
status such as risk responses that have been implemented, risks that have
occurred, risks that are active and those that have been closed out.
11.7.1.4 WORK PERFORMANCE REPORTS
Described in Section 4.5.3.1. Work performance reports provide information
from performance measurements that can be analyzed to provide project work
performance information including variance analysis, earned value data, and
forecasting data. This information could be relevant when monitoring
performance-related risks.
11.7.2 MONITOR RISKS: TOOLS AND TECHNIQUES
11.7.2.1 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Technical performance analysis. Technical performance analysis
compares technical accomplishments during project execution to the
schedule of technical achievement. It requires the definition of
objective, quantifiable measures of technical performance, which can
be used to compare actual results against targets. Such technical
performance measures may include weight, transaction times, number
of delivered defects, storage capacity, etc. Deviation can indicate the
potential impact of threats or opportunities.
Reserve analysis. Described in Section 7.2.2.6. Throughout execution
of the project, some individual project risks may occur with positive or
negative impacts on budget or schedule contingency reserves. Reserve
analysis compares the amount of the contingency reserves remaining
to the amount of risk remaining at any time in the project in order to
determine if the remaining reserve is adequate. This may be
communicated using various graphical representations, including a
burndown chart.
11.7.2.2 AUDITS
Described in Section 8.2.2.5. Risk audits are a type of audit that may be used
to consider the effectiveness of the risk management process. The project
manager is responsible for ensuring that risk audits are performed at an
appropriate frequency, as defined in the project's risk management plan. Risk
audits may be included during routine project review meetings or may form part
of a risk review meeting, or the team may choose to hold separate risk audit
meetings. The format for the risk audit and its objectives should be clearly
defined before the audit is conducted.
11.7.2.3 MEETINGS
Meetings that can be used during this process include but are not limited to
risk reviews. Risk reviews are scheduled regularly and should examine and
document the effectiveness of risk responses in dealing with overall project risk
and with identified individual project risks. Risk reviews may also result in
identification of new individual project risks, (including secondary risks that
arise from agreed-upon risk responses), reassessment of current risks, the closing
of risks that are outdated, issues that have arisen as the result of risks that have
occurred, and identification of lessons to be learned for implementation in
ongoing phases in the current project or in similar projects in the future. The risk
review may be conducted as part of a periodic project status meeting or a
dedicated risk review meeting may be held, as specified in the risk management
plan.
11.7.3 MONITOR RISKS: OUTPUTS
11.7.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how project risk management is performing by comparing the
individual risks that have occurred with the expectation of how they would
occur. This information indicates the effectiveness of the response planning and
response implementation processes.
11.7.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. The Monitor Risks process may result in a
change request to the cost and schedule baselines or other components of the
project management plan. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
Change requests can include recommended corrective and preventive actions
to address the current level of overall project risk or to address individual project
risks.
11.7.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. This may affect any component of
the project management plan.
11.7.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. During the Monitor
Risks process, new assumptions may be made, new constraints may be
identified, and existing assumptions or constraints may be revisited
and changed. The assumption log is updated with this new
information.
Issue log. Described in Section 4.3.3.3. Where issues are identified as
part of the Monitor Risks process, these are recorded in the issue log.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with any risk-related lessons learned during
risk reviews so these can be used on later phases of the project or in
future projects.
Risk register. Described in Section 11.2.3.1. The risk register is
updated with information on individual project risks generated during
the Monitor Risks process. This may include adding new risks,
updating outdated risks or risks that were realized, updating risk
responses, and so forth.
Risk report. Described in Section 11.2.3.2. As new information
becomes available through the Monitor Risks process, the risk report is
updated to reflect the current status of major individual project risks
and the current level of overall project risk. The risk report may also
include details of the top individual project risks, agreed-upon
responses and owners, and conclusions and recommendations. It may
also include conclusions from risk audits on the effectiveness of the
risk management process.
11.7.3.5 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that are updated as a result of the Monitor Risks
process include but are not limited to:
Templates for the risk management plan, risk register, and risk report;
and
Risk breakdown structure.
12
PROJECT PROCUREMENT MANAGEMENT
Project Procurement Management includes the processes necessary to
purchase or acquire products, services, or results needed from outside the project
team. Project Procurement Management includes the management and control
processes required to develop and administer agreements such as contracts,
purchase orders, memoranda of agreements (MOAs), or internal service level
agreements (SLAs). The personnel authorized to procure the goods and/or
services required for the project may be members of the project team,
management, or part of the organization's purchasing department if applicable.
Project Procurement Management processes include the following:
12.1 Plan Procurement Management—The process of documenting project
procurement decisions, specifying the approach, and identifying potential sellers.
12.2 Conduct Procurements—The process of obtaining seller responses,
selecting a seller, and awarding a contract.
12.3 Control Procurements—The process of managing procurement
relationships, monitoring contract performance, making changes and corrections
as appropriate, and closing out contracts.
The procurement processes are presented as discrete processes with defined
interfaces. In practice, procurement processes can be complex and can interact
with each other and with processes in other Knowledge Areas in ways that
cannot be completely detailed in the PMBOK® Guide. The processes described
in this section are written from the viewpoint where goods or services are
obtained from outside of the project.
Figure 12-1 provides an overview of the Project Procurement Management
processes. The Project Procurement Management processes are presented as
discrete processes with defined interfaces while, in practice, they overlap and
interact in ways that cannot be completely detailed in the PMBOK® Guide.
KEY CONCEPTS FOR PROJECT PROCUREMENT MANAGEMENT
More than most other project management processes, there can be significant
legal obligations and penalties tied to the procurement process. The project
manager does not have to be a trained expert in procurement management laws
and regulations but should be familiar enough with the procurement process to
make intelligent decisions regarding contracts and contractual relationships. The
project manager is typically not authorized to sign legal agreements binding the
organization; this is reserved for those who have the authority to do so.
The Project Procurement Management processes involve agreements that
describe the relationship between two parties—a buyer and a seller. Agreements
can be as simple as the purchase of a defined quantity of labor hours at a
specified labor rate, or they can be as complex as multiyear international
construction contracts. The contracting approach and the contract itself should
reflect the simplicity or complexity of the deliverables or required effort and
should be written in a manner that complies with local, national, and
international laws regarding contracts.
A contract should clearly state the deliverables and results expected, including
any knowledge transfer from the seller to the buyer. Anything not in the contract
cannot be legally enforced. When working internationally, project managers
should keep in mind the effect that culture and local law have upon contracts and
their enforceability, no matter how clearly a contract is written.
A purchasing contract includes terms and conditions and may incorporate
other buyer specifics as to what the seller is to perform or provide. It is the
project management team's responsibility to make certain that all procurements
meet the specific needs of the project while working with the procurement office
to ensure organizational procurement policies are followed. Depending on the
application area, an agreement can be a contract, an SLA, an understanding, an
MOA, or a purchase order.
Most organizations document policies and procedures specifically defining
procurement rules and specifying who has authority to sign and administer such
agreements on behalf of the organization. Across the world, organizations use
different names for departments or divisions that deal with procurement, such as
purchasing, contracting, procurement, or acquisitions; however, the
responsibilities are likely to be similar.
Although all project documents may be subject to some form of review and
approval, the legally binding nature of a contract means it will be subjected to a
more extensive approval process, often involving the legal department. In all
cases, the primary focus of the review and approval process is to ensure that the
contract adequately describes the products, services, or results that the seller is
agreeing to provide, while being in compliance with the laws and regulations
regarding procurements. These sections are often separate appendices or
annexes, allowing standardized legal contract language to be used.
A complex project may involve managing multiple contracts simultaneously
or in sequence. In such cases, each contract life cycle may begin and end during
any phase of the project life cycle. The buyer-seller relationship may exist at
many levels on any one project, and between organizations internal to and
external to the acquiring organization.
Depending on the application area, the seller may be identified as a contractor,
vendor, service provider, or supplier. The buyer may be the owner of the final
product, a subcontractor, the acquiring organization, a service requestor, or the
purchaser. The seller can be viewed during the contract life cycle first as a
bidder, then as the selected source, and then as the contracted supplier or vendor.
The winning bidder may manage the work as a project. In such cases:
The buyer becomes the customer to subcontractors, suppliers, and
service providers and is therefore a key project stakeholder from the
seller's perspective.
The seller's project management team may be concerned with all the
processes involved in performing the work or providing the services.
Terms and conditions of the contract and the procurement statement of
work (SOW) become key inputs to many of the seller's management
processes. The contract can actually contain the inputs (e.g., major
deliverables, key milestones, cost objectives) or it can limit the project
team's options (for example, buyer approval of staffing decisions is
often required on IT integration projects). The procurement SOW may
have other names, such as the technical statement of work.
The seller itself may become a buyer of lower-tiered products,
services, and materials from subcontractors and suppliers.
In this section, it is assumed that the buyer of an item for the project is
assigned to the project team and/or is part of the larger organization. The seller is
assumed to be providing services and/or materials to the project and is usually
outside the performing organization. For some projects, the seller role may be
filled by a group or function that is part of the performing organization but
external to the project. For larger, more complex projects, the seller may become
part of an integrated project team after the contract is awarded.
For smaller organizations or startup companies and those without a
purchasing, contracting, or procurement department, the project manager may
assume the purchasing authority role to negotiate and sign contracts directly
(decentralized purchasing). For more mature organizations, the actual
procurement and contracting functions will be carried out by a separate
department with the specific role to purchase, negotiate, and sign contracts
(centralized purchasing).
In international contracting, the legal jurisdictions under which the contracts
will be administered are clearly spelled out in the contract. In most cases, the
seller is an external contractor who is bound by a formal contractual relationship.
TRENDS AND EMERGING PRACTICES IN PROCUREMENT
MANAGEMENT
There are a number of major trends in software tools, risk, processes, logistics,
and technology with different industries that can affect the success rate of
projects. Trends and emerging practices for Project Procurement Management
include but are not limited to:
Advances in tools. There has been significant improvement in the
development of tools to manage the procurement and implementation
phases of a project. Online tools for procurement now give the buyers
a single point where procurements can be advertised and provide
sellers with a single source to find procurement documents and
complete them directly online. In the
construction/engineering/infrastructure field, the increasing use of the
building information model (BIM) in software tools has been shown to
save significant amounts of time and money on projects using it. This
approach can substantially reduce construction claims, thereby
reducing both costs and schedule. Major companies and governments
worldwide are beginning to mandate the use of BIM on large projects.
More advanced risk management. An increasing trend in risk
management is to write contracts that accurately allocate specific risks
to those entities most capable of managing them. No contractor is
capable of managing all the possible major risks on a project. The
buyer will be required to accept the risks that the contractors do not
have control over, such as changing corporate policies in the buying
organization, changing regulatory requirements, and other risks from
outside the project. Contracts may specify that risk management be
performed as part of the contract.
Changing contracting processes. There has been a significant growth
in megaprojects in the past several years, particularly in the areas of
infrastructure development and engineering projects. Multibillion-
dollar projects are now common. A large proportion of these involve
international contracts with multiple contractors from many countries
and are inherently more risky than projects using only local
contractors. Increasingly, the contractor works closely with the client
in the procurement process to take advantage of discounts through
quantity purchases or other special considerations. For these projects,
the use of internationally recognized standard contract forms is
increasing in order to reduce problems and claims during execution.
Logistics and supply chain management. Because so many large
engineering, construction infrastructure projects are done through
multiple international contractors, the management of the flow of
materials becomes critical to successful completion. For long-lead
items, both the manufacture of the items and their transportation to the
project site become schedule-drivers. In the IT field, a long-lead item
may require ordering 2 to 3 months in advance. In complex
construction projects, long-lead items may require ordering 1 to 2
years in advance or longer. For these projects, long-lead items may be
procured in advance of other procurement contracts to meet the
planned project completion date. It is possible to begin contracting for
these long-lead materials, supplies, or equipment before the final
design of the end product itself is completed based on the known
requirements identified in the top-level design. The management of the
supply chain is an area of increasing emphasis by the contractor's
project team. Not only are primary sources of supplies identified early
in the project, but secondary, back-up sources are also generally
identified. Many countries around the world require international
contractors to purchase certain minimum percentages of material and
supplies from local vendors.
Technology and stakeholder relations. Publicly funded projects are
under increasing scrutiny. A trend in infrastructure and commercial
construction projects is the use of technology including web cameras
(webcams) to improve stakeholder communications and relations.
During construction, one or more webcams are installed on the site,
with periodic updates to a publicly available website. The progress on
the project can be viewed on the Internet by all stakeholders. Video
data can also be stored, allowing analysis if a claim arises. Some
projects have discovered that the use of webcams minimizes disputes
relating to the construction work on site, as the webcam has recorded
the events, so there should be no disagreement about the facts of the
matter.
Trial engagements. Not every seller is well suited for an organization's
environment. Therefore, some projects will engage several candidate
sellers for initial deliverables and work products on a paid basis before
making the full commitment to a larger portion of the project scope.
This accelerates momentum by allowing the buyer to evaluate
potential partners, while simultaneously making progress on project
work.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager may need to tailor the
way that Project Procurement Management processes are applied.
Considerations for tailoring include but are not limited to:
Complexity of procurement. Is there one main procurement or are
there multiple procurements at different times with different sellers
that add to the complexity of the procurements?
Physical location. Are the buyers and sellers in the same location, or
reasonably close, or in different time zones, countries, or continents?
Governance and regulatory environment. Are local laws and
regulations regarding procurement activities integrated with the
organization's procurement policies? How does this affect contract
auditing requirements?
Availability of contractors. Are there available contractors who are
capable of performing the work?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
In agile environments, specific sellers may be used to extend the team. This
collaborative working relationship can lead to a shared risk procurement model
where both the buyer and the seller share in the risk and rewards associated with
a project.
Larger projects may use an adaptive approach for some deliverables and a
more stable approach for other parts. In these cases, a governing agreement such
as a master services agreement (MSA) may be used for the overall engagement,
with the adaptive work being placed in an appendix or supplement. This allows
changes to occur on the adaptive scope without impacting the overall contract.
12.1 PLAN PROCUREMENT MANAGEMENT
Plan Procurement Management is the process of documenting project
procurement decisions, specifying the approach and identifying potential sellers.
The key benefit of this process is that it determines whether to acquire goods and
services from outside the project and, if so, what to acquire as well as how and
when to acquire it. Goods and services may be procured from other parts of the
performing organization or from external sources. This process is performed
once or at predefined points in the project. The inputs, tools and techniques, and
outputs of this process are depicted in Figure 12-2. Figure 12-3 depicts the data
flow diagram of the process.
Defining roles and responsibilities related to procurement should be done
early in the Plan Procurement Management process. The project manager should
ensure that the project team is staffed with procurement expertise at the level
required for the project. Participants in the procurement process may include
personnel from the purchasing or procurement department as well as personnel
from the buying organization's legal department. These responsibilities should be
documented in the procurement management plan.
Typical steps might be:
Prepare the procurement statement of work (SOW) or terms of
reference (TOR).
Prepare a high-level cost estimate to determine the budget.
Advertise the opportunity.
Identify a short list of qualified sellers.
Prepare and issue bid documents.
Prepare and submit proposals by the seller.
Conduct a technical evaluation of the proposals including quality.
Perform a cost evaluation of the proposals.
Prepare the final combined quality and cost evaluation to select the
winning proposal.
Finalize negotiations and sign contract between the buyer and the
seller.
The requirements of the project schedule can significantly influence the
strategy during the Plan Procurement Management process. Decisions made in
developing the procurement management plan can also influence the project
schedule and are integrated with the Develop Schedule process, the Estimate
Activity Resources process, and make-or-buy decisions.
12.1.1 PLAN PROCUREMENT MANAGEMENT: INPUTS
12.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter contains the objectives,
project description, summary milestones, and the preapproved financial
resources.
12.1.1.2 BUSINESS DOCUMENTS
Described in Section 1.2.6. The business documents include the following:
Business case. The procurement strategy and business case need to be
aligned to ensure the business case remains valid.
Benefits management plan. The benefits management plan describes
when specific project benefits are expected to be available, which will
drive procurement dates and contract language.
12.1.1.3 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan describes how the scope of work by the contractors
will be managed through the execution phase of the project.
Quality management plan. Described in Section 8.1.3.1. The quality
management plan contains the applicable industry standards and codes
the project is required to follow. This information is used in bidding
documents such as the RFP and will eventually be referenced in the
contract. This information may be used in supplier prequalification or
as part of the selection criteria.
Resource management plan. Described in Section 9.1.3.1. The
resource management plan has information on which resources will be
purchased or leased, along with any assumptions or constraints that
would influence the procurement.
Scope baseline. Described in Section 5.4.3.1. The scope baseline
contains the scope statement, WBS, and WBS dictionary. Early in the
project, the project scope may still be evolving. The elements of the
scope that are known are used to develop the statement of work
(SOW) and the terms of reference (TOR).
12.1.1.4 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Milestone list. Described in Section 6.2.3.3. This list of major
milestones show when the sellers are required to deliver their results.
Project team assignments. Described in Section 9.3.3.2. The project
team assignments contain information on the skills and abilities of the
project team and their availability to support the procurement
activities. If the project team does not have the skills to perform the
procurement activities for which they are responsible, additional
resources will need to be acquired or training will need to be provided,
or both.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may include:
Technical requirements that the seller is required to satisfy, and
Requirements with contractual and legal implications that may
include health, safety, security, performance, environmental,
insurance, intellectual property rights, equal employment
opportunity, licenses, permits, and other nontechnical requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix links product requirements from their
origin to the deliverables that satisfy them.
Resource requirements. Described in Section 9.2.3.1. Resource
requirements contain information on specific needs such as team and
phyisical resources that may need to be acquired.
Risk register. Described in Section 11.2.3.1. The risk register provides
the list of risks, along with the results of risk analysis and risk response
planning. Some risks are transferred via a procurement agreement.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register provides details on the project participants and their interests
in the project, including regulatory agencies, contracting personnel,
and legal personnel.
12.1.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Plan Procurement
Management process include but are not limited to:
Marketplace conditions;
Products, services, and results that are available in the marketplace;
Sellers, including their past performance or reputation;
Typical terms and conditions for products, services, and results or for
the specific industry;
Unique local requirements, such as regulatory requirements for local
labor or sellers;
Legal advice regarding procurements;
Contract management systems, including procedures for contract
change control;
Established multi-tier supplier system of prequalified sellers based on
prior experience; and
Financial accounting and contract payments system.
12.1.1.6 ORGANIZATIONAL PROCESS ASSETS
The various types of contractual agreements used by the organization also
influence decisions for the Plan Procurement Management process. The
organizational process assets that can influence the Plan Procurement
Management process include but are not limited to:
Preapproved seller lists. Lists of sellers that have been properly vetted
can streamline the steps needed to advertise the opportunity and
shorten the timeline for the seller selection process.
Formal procurement policies, procedures, and guidelines. Most
organizations have formal procurement policies and buying
organizations. When such procurement support is not available, the
project team should supply both the resources and the expertise to
perform such procurement activities.
Contract types. All legal contractual relationships generally fall into
one of two broad families: either fixed-price or cost-reimbursable.
Also, there is a third hybrid type commonly used called the time and
materials contract. The more popular contract types in use are
discussed below as discrete types, but, in practice, it is not unusual to
combine one or more types into a single procurement.
Fixed-price contracts. This category of contracts involves setting a
fixed total price for a defined product, service, or result to be
provided. These contracts should be used when the requirements are
well defined and no significant changes to the scope are expected.
Types of fixed-price contract include:
Firm fixed price (FFP). The most commonly used contract type
is the FFP. It is favored by most buying organizations because the
price for goods is set at the outset and not subject to change
unless the scope of work changes.
Fixed price incentive fee (FPIF). This fixed-price arrangement
gives the buyer and seller some flexibility in that it allows for
deviation from performance, with financial incentives tied to
achieving agreed-upon metrics. Typically, such financial
incentives are related to cost, schedule, or technical performance
of the seller. Under FPIF contracts, a price ceiling is set, and all
costs above the price ceiling are the responsibility of the seller.
Fixed price with economic price adjustments (FPEPA). This
type is used whenever the seller's performance period spans a
considerable period of years, or if the payments are made in a
different currency. It is a fixed-price contract, but with a special
provision allowing for predefined final adjustments to the
contract price due to changed conditions, such as inflation
changes or cost increases (or decreases) for specific commodities.
Cost-reimbursable contracts. This category of contract involves
payments (cost reimbursements) to the seller for all legitimate actual
costs incurred for completed work, plus a fee representing seller profit.
This type should be used if the scope of work is expected to change
significantly during the execution of the contract. Variations can
include:
Cost plus fixed fee (CPFF). The seller is reimbursed for all
allowable costs for performing the contract work and receives a
fixed-fee payment calculated as a percentage of the initial estimated
project costs. Fee amounts do not change unless the project scope
changes.
Cost plus incentive fee (CPIF). The seller is reimbursed for all
allowable costs for performing the contract work and receives a
predetermined incentive fee based on achieving certain performance
objectives as set forth in the contract. In CPIF contracts, if the final
costs are less or greater than the original estimated costs, then both
the buyer and seller share costs from the departures based upon a
prenegotiated cost-sharing formula, for example, an 80/20 split
over/under target costs based on the actual performance of the seller.
Cost plus award fee (CPAF). The seller is reimbursed for all
legitimate costs, but the majority of the fee is earned based on the
satisfaction of certain broad subjective performance criteria that are
defined and incorporated into the contract. The determination of fee
is based solely on the subjective determination of seller performance
by the buyer and is generally not subject to appeals.
Time and material contracts (T&M). Time and material contracts (also
called time and means) are a hybrid type of contractual arrangement
with aspects of both cost-reimbursable and fixed-price contracts. They
are often used for staff augmentation, acquisition of experts, and any
outside support when a precise statement of work cannot be quickly
prescribed.
12.1.2 PLAN PROCUREMENT MANAGEMENT: TOOLS AND
TECHNIQUES
12.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Procurement and purchasing,
Contract types and contract documents, and
Regulations and compliance topics.
12.1.2.2 DATA GATHERING
A data-gathering technique that can be used for this process includes but is not
limited to market research. Market research includes examination of industry
and specific seller capabilities. Procurement teams may leverage information
gained at conferences, online reviews, and a variety of sources to identify market
capabilities. The team may also refine specific procurement objectives to
leverage maturing technologies while balancing risks associated with the breadth
of sellers who can provide the desired materials or services.
12.1.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to make-or-buy analysis. A make-or-buy analysis is used to determine
whether work or deliverables can best be accomplished by the project team or
should be purchased from outside sources. Factors to consider in the make-or-
buy decision include the organization's current resource allocation and their
skills and abilities, the need for specialized expertise, the desire to not expand
permanent employment obligations, and the need for independent expertise. It
also includes evaluating the risks involved with each make-or-buy decision.
Make-or-buy analysis may use payback period, return on investment (ROI),
internal rate of return (IRR), discounted cash flow, net present value (NPV),
benefit/cost analysis (BCA), or other techniques in order to decide whether to
include something as part of the project or purchase it externally.
12.1.2.4 SOURCE SELECTION ANALYSIS
It is necessary to review the prioritization of the competing demands for the
project before deciding on the selection method. Since competitive selection
methods may require sellers to invest a large amount of time and resources
upfront, it is a good practice to include the evaluation method in the procurement
documents so bidders know how they will be evaluated. Commonly used
selection methods include the following:
Least cost. The least cost method may be appropriate for procurements
of a standard or routine nature where well-established practices and
standards exist and from which a specific and well-defined outcome is
expected, which can be executed at different costs.
Qualifications only. The qualifications only selection method applies
when the time and cost of a full selection process would not make
sense because the value of the procurement is relatively small. The
buyer establishes a short list and selects the bidder with the best
credibility, qualifications, experience, expertise, areas of
specialization, and references.
Quality-based/highest technical proposal score. The selected firm is
asked to submit a proposal with both technical and cost details and is
then invited to negotiate the contract if the technical proposal proves
acceptable. Using this method, technical proposals are first evaluated
based on the quality of the technical solution offered. The seller who
submitted the highest-ranked technical proposal is selected if their
financial proposal can be negotiated and accepted.
Quality and cost-based. The quality and cost-based method allows cost
to be included as a factor in the seller selection process. In general,
when risk and/or uncertainty are greater for the project, quality should
be a key element when compared to cost.
Sole source. The buyer asks a specific seller to prepare technical and
financial proposals, which are then negotiated. Since there is no
competition, this method is acceptable only when properly justified
and should be viewed as an exception.
Fixed budget. The fixed-budget method requires disclosing the
available budget to invited sellers in the RFP and selecting the highest-
ranking technical proposal within the budget. Because sellers are
subject to a cost constraint, they will adapt the scope and quality of
their offer to that budget. The buyer should therefore ensure that the
budget is compatible with the SOW and that the seller will be able to
perform the tasks within the budget. This method is appropriate only
when the SOW is precisely defined, no changes are anticipated, and
the budget is fixed and cannot be exceeded.
12.1.2.5 MEETINGS
Research alone may not provide specific information to formulate a
procurement strategy without additional information interchange meetings with
potential bidders. By collaborating with potential bidders, the organization
purchasing the material or service may benefit while the seller can influence a
mutually beneficial approach or product. Meetings can be used to determine the
strategy for managing and monitoring the procurement.
12.1.3 PLAN PROCUREMENT MANAGEMENT: OUTPUTS
12.1.3.1 PROCUREMENT MANAGEMENT PLAN
The procurement management plan contains the activities to be undertaken
during the procurement process. It should document whether international
competitive bidding, national competitive bidding, local bidding, etc., should be
done. If the project is financed externally, the sources and availability of funding
should be aligned with the procurement management plan and the project
schedule.
The procurement management plan can include guidance for:
How procurement will be coordinated with other project aspects, such
as project schedule development and control processes;
Timetable of key procurement activities;
Procurement metrics to be used to manage contracts;
Stakeholder roles and responsibilities related to procurement,
including authority and constraints of the project team when the
performing organization has a procurement department;
Constraints and assumptions that could affect planned procurements;
The legal jurisdiction and the currency in which payments will be
made;
Determination of whether independent estimates will be used and
whether they are needed as evaluation criteria;
Risk management issues including identifying requirements for
performance bonds or insurance contracts to mitigate some forms of
project risk; and
Prequalified sellers, if any, to be used.
A procurement management plan can be formal or informal, can be highly
detailed or broadly framed, and is based upon the needs of each project.
12.1.3.2 PROCUREMENT STRATEGY
Once the make-or-buy analysis is complete and the decision is made to
acquire from outside the project, a procurement strategy should be identified.
The objective of the procurement strategy is to determine the project delivery
method, the type of legally binding agreement(s), and how the procurement will
advance through the procurement phases.
Delivery methods. Delivery methods are different for professional
services versus construction projects.
For professional services, delivery methods include: buyer/services
provider with no subcontracting, buyer/services provider with
subcontracting allowed, joint venture between buyer and services
provider, and buyer/services provider acts as the representative.
For industrial or commercial construction, project delivery methods
include but are not limited to: turnkey, design build (DB), design bid
build (DBB), design build operate (DBO), build own operate transfer
(BOOT), and others.
Contract payment types. Contract payment types are separate from the
project delivery methods and are coordinated with the buying
organization's internal financial systems. They include but are not
limited to these contract types plus variations: lump sum, firm fixed
price, cost plus award fees, cost plus incentive fees, time and
materials, target cost, and others.
Fixed-price contracts are suitable when the type of work is
predictable and the requirements are well defined and not likely to
change.
Cost plus contracts are suitable when the work is evolving, likely to
change, or not well defined.
Incentives and awards may be used to align the objectives of buyer
and seller.
Procurement phases. The procurement strategy can also include
information on procurement phases. Information may include:
Sequencing or phasing of the procurement, a description of each
phase and the specific objectives of each phase;
Procurement performance indicators and milestones to be used in
monitoring;
Criteria for moving from phase to phase;
Monitoring and evaluation plan for tracking progress; and
Process for knowledge transfer for use in subsequent phases.
12.1.3.3 BID DOCUMENTS
Bid documents are used to solicit proposals from prospective sellers. Terms
such as bid, tender, or quotation are generally used when the seller selection
decision is based on price (as when buying commercial or standard items), while
a term such as proposal is generally used when other considerations such as
technical capability or technical approach are the most important. Specific
procurement terminology used may vary by industry and location of the
procurement.
Depending on the goods or services needed, the bidding documents can
include a request for information, request for quotation, request for proposal, or
other appropriate procurement documents. The conditions involving their use are
presented below:
Request for information (RFI). An RFI is used when more information
on the goods and services to be acquired is needed from the sellers. It
will typically be followed by an RFQ or RFP.
Request for quotation (RFQ). An RFQ is commonly used when more
information is needed on how vendors would satisfy the requirements
and/or how much it will cost.
Request for proposal (RFP). An RFP is used when there is a problem
in the project and the solution is not easy to determine. This is the
most formal of the “request for” documents and has strict procurement
rules for content, timeline, and seller responses.
The buyer structures procurement documents to facilitate an accurate and
complete response from each prospective seller and to facilitate easy evaluation
of the responses. These documents include a description of the desired form of
the response, the relevant procurement SOW, and any required contractual
provisions.
The complexity and level of detail of the procurement documents should be
consistent with the value of, and risks associated with, the planned procurement.
Procurement documents are required to be sufficiently detailed to ensure
consistent, appropriate responses, but flexible enough to allow consideration of
any seller suggestions for better ways to satisfy the same requirements.
12.1.3.4 PROCUREMENT STATEMENT OF WORK
The statement of work (SOW) for each procurement is developed from the
project scope baseline and defines only that portion of the project scope that is to
be included within the related contract. The SOW describes the procurement
item in sufficient detail to allow prospective sellers to determine if they are
capable of providing the products, services, or results. Sufficient detail can vary
based on the nature of the item, the needs of the buyer, or the expected contract
form. Information included in a SOW can include specifications, quantity
desired, quality levels, performance data, period of performance, work location,
and other requirements.
The procurement SOW should be clear, complete, and concise. It includes a
description of any collateral services required, such as performance reporting or
post-project operational support for the procured item. The SOW can be revised
as required as it moves through the procurement process until incorporated into a
signed agreement.
The phrase terms of reference (TOR) is sometimes used when contracting for
services. Similar to the procurement SOW, a TOR typically includes these
elements:
Tasks the contractor is required to perform as well as specified
coordination requirements;
Standards the contractor will fulfill that are applicable to the project;
Data that needs to be submitted for approval;
Detailed list of all data and services that will be provided to the
contractor by the buyer for use in performing the contract, if
applicable; and
Definition of the schedule for initial submission and the
review/approval time required.
12.1.3.5 SOURCE SELECTION CRITERIA
In choosing evaluation criteria, the buyer seeks to ensure that the proposal
selected will offer the best quality for the services required. The source selection
criteria may include but are not limited to:
Capability and capacity;
Product cost and life cycle cost;
Delivery dates;
Technical expertise and approach;
Specific relevant experience;
Adequacy of the proposed approach and work plan in responding to
the SOW;
Key staff's qualifications, availability, and competence;
Financial stability of the firm;
Management experience; and
Suitability of the knowledge transfer program, including training.
For international projects, evaluation criteria may include “local content”
requirements, for example, participation by nationals among proposed key staff.
The specific criteria may be a numerical score, color-code, or a written
description of how well the seller satisfies the buying organization's needs. The
criteria will be part of a weighting system that can be used to select a single
seller that will be asked to sign a contract and establish a negotiating sequence
by ranking all the proposals by the weighted evaluation scores assigned to each
proposal.
12.1.3.6 MAKE-OR-BUY DECISIONS
A make-or-buy analysis results in a decision as to whether particular work can
best be accomplished by the project team or needs to be purchased from outside
sources.
12.1.3.7 INDEPENDENT COST ESTIMATES
For large procurements, the procuring organization may elect to either prepare
its own independent estimate or have a cost estimate prepared by an outside
professional estimator to serve as a benchmark on proposed responses.
Significant differences in cost estimates can be an indication that the
procurement SOW was deficient or ambiguous, or that the prospective sellers
either misunderstood or failed to respond fully to the procurement SOW.
12.1.3.8 CHANGE REQUESTS
Described in Section 4.3.3.4. A decision that involves procuring goods,
services, or resources may require a change request. Other decisions during
procurement planning can also create the need for additional change requests.
Changes to the project management plan, its subsidiary plans, and other
components may result in change requests that impact procurement actions.
Change requests are processed for review and disposition through the Perform
Integrated Change Control process (Section 4.6).
12.1.3.9 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with any relevant lessons regarding
regulations and compliance, data gathering, data analysis, and source
selection analysis.
Milestone list. Described in Section 6.2.3.3. This list of major
milestones shows when the sellers are expected to deliver their results.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may include:
Technical requirements that the seller is required to satisfy, and
Requirements with contractual and legal implications that may
include health, safety, security, performance, environmental,
insurance, intellectual property rights, equal employment
opportunity, licenses, permits, and other nontechnical requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix links product requirements from their
origin to the deliverables that satisfy them.
Risk register. Described in Section 11.2.3.1. Each approved seller
comes with its own unique set of risks, depending on the seller's
organization, the duration of the contract, the external environment,
the project delivery method, the type of contracting vehicle chosen,
and the final agreed-upon price.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register is updated with any additional information on stakeholders,
particularly regulatory agencies, contracting personnel, and legal
personnel.
12.1.3.10 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that are updated as a result of the Plan
Procurement Management process include but are not limited to information on
qualified sellers.
For projects with few procurements and relatively simple procurements, some
of these outputs may be combined. However, for projects with large, complex
procurements and where much of the work is done by contractors, there are
several different types of documentation. Table 12-1 is a representative list of
common types of documents used in procurements and some of their contents.
Given the legal nature of procurements, this list should not be considered
prescriptive, but rather it should be used as a general outline of types of
documents and contents needed to conduct procurement. The organization,
environment, and legal constraints dictate the required procurement documents
and information needed for the project.
12.2 CONDUCT PROCUREMENTS
Conduct Procurements is the process of obtaining seller responses, selecting a
seller, and awarding a contract. The key benefit of this process is that it selects a
qualified seller and implements the legal agreement for delivery. The end results
of the process are the established agreements including formal contracts. This
process is performed periodically throughout the project as needed. The inputs,
tools and techniques, and outputs of the Conduct Procurements process are
depicted in Figure 12-4. Figure 12-5 depicts the data flow diagram for the
process.
12.2.1 CONDUCT PROCUREMENTS: INPUTS
12.2.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Scope management plan. Described in Section 5.1.3.1. The scope
management plan describes how the overall scope of work will be
managed, including the scope performed by sellers.
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan describes how requirements will be
analyzed, documented, and managed. The requirements management
plan may include how sellers will manage the requirements they are
under agreement to satisfy.
Communications management plan. Described in Section 10.1.3.1.
The communications management plan describes how
communications between buyers and sellers will be conducted.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan is a component of the project management plan and
describes how risk management activities will be structured and
performed for the project.
Procurement management plan. Described in Section 12.1.3.1. The
procurement management plan contains the activities to be undertaken
during the Conduct Procurements process.
Configuration management plan. Described in Section 5.6.1.1. The
configuration management plan defines those items that are
configurable, those items that require formal change control, and the
process for controlling changes to such items. It includes formats and
processes for how sellers will provide configuration management in a
way that is consistent with the buyer's approach.
Cost baseline. Described in Section 7.3.3.1. The cost baseline includes
the budget for the procurement as well as costs associated with
managing the procurement process and sellers.
12.2.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to conducting procurements can be
applied to later phases in the project to improve the efficiency of this
process.
Project schedule. Described in Section 6.5.3.2. The project schedule
identifies the start and end dates of project activities, including
procurement activities. It also defines when contractor deliverables are
due.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may include:
Technical requirements the seller is required to satisfy, and
Requirements with contractual and legal implications that may
include health, safety, security, performance, environmental,
insurance, intellectual property rights, equal employment
opportunity, licenses, permits, and other nontechnical requirements.
Risk register. Described in Section 11.2.3.1. Each approved seller
comes with its own unique set of risks, depending on the seller's
organization, the duration of the contract, the external environment,
the project delivery method, the type of contracting vehicle chosen,
and the final agreed-upon price.
Stakeholder register. Described in Section 13.1.3.1. This document
contains all of the details about the identified stakeholders.
12.2.1.3 PROCUREMENT DOCUMENTATION
Procurement documentation provides a written record used in reaching the
legal agreement, and may include older documents predating the current project.
Procurement documentation can include:
Bid documents. Described in Section 12.1.3.3. Procurement
documents include the RFI, RFP, RFQ, or other documents sent to
sellers so they can develop a bid response.
Procurement statement of work. Described in Section 12.1.3.4. The
procurement statement of work (SOW) provides sellers with a clearly
stated set of goals, requirements, and outcomes from which they can
provide a quantifiable response.
Independent cost estimates. Described in Section 12.1.3.7.
Independent cost estimates are developed either internally or by using
external resources and provide a reasonableness check against the
proposals submitted by bidders.
Source selection criteria. Described in Section 12.1.3.5. These criteria
describe how bidder proposals will be evaluated, including evaluation
criteria and weights. For risk mitigation, the buyer may decide to sign
agreements with more than one seller to mitigate damage caused by a
single seller having problems that impact the overall project.
12.2.1.4 SELLER PROPOSALS
Seller proposals, prepared in response to a procurement document package,
form the basic information that will be used by an evaluation body to select one
or more successful bidders (sellers). If the seller is going to submit a price
proposal, good practice is to require that it be separate from the technical
proposal. The evaluation body reviews each submitted proposal according to the
source selection criteria and selects the seller that can best satisfy the buying
organization's requirements.
12.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Conduct
Procurements Process include:
Local laws and regulations regarding procurements;
Local laws and regulations ensuring that the major procurements
involve local sellers;
External economic environment constraining procurement processes;
Marketplace conditions;
Information on relevant past experience with sellers, both good and
bad;
Prior agreements already in place; and
Contract management systems.
12.2.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Conduct
Procurements process include but are not limited to:
List of preferred sellers that have been prequalified,
Organizational policies that influence the selection of a seller,
Specific organizational templates or guidelines that will determine the
way agreements are drafted and built, and
Financial policies and procedures regarding invoicing and payment
processes.
12.2.2 CONDUCT PROCUREMENTS: TOOLS AND
TECHNIQUES
12.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Proposal evaluation;
Technical or subject matter;
Relevant functional areas such as finance, engineering, design,
development, supply chain management, etc.;
Industry regulatory environment;
Laws, regulations, and compliance requirements; and
Negotiation.
12.2.2.2 ADVERTISING
Advertising is communicating with users or potential users of a product,
service, or result. Existing lists of potential sellers often can be expanded by
placing advertisements in general circulation publications such as selected
newspapers or in specialty trade publications. Most government jurisdictions
require public advertising or online posting of pending government contracts.
12.2.2.3 BIDDER CONFERENCES
Bidder conferences (also called contractor conferences, vendor conferences,
and pre-bid conferences) are meetings between the buyer and prospective sellers
prior to proposal submittal. They are used to ensure that all prospective bidders
have a clear and common understanding of the procurement and no bidders
receive preferential treatment.
12.2.2.4 DATA ANALYSIS
A data analysis technique that can be used for this process includes but is not
limited to proposal evaluation. Proposals are evaluated to ensure they are
complete and respond in full to the bid documents, procurement statement of
work, source selection criteria, and any other documents that went out in the bid
package.
12.2.2.5 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include
negotiation. Negotiation is a discussion aimed at reaching an agreement.
Procurement negotiation clarifies the structure, rights, and obligations of the
parties and other terms of the purchases so that mutual agreement can be reached
prior to signing the contract. Final document language reflects all agreements
reached. Negotiation concludes with a signed contract document or other formal
agreement that can be executed by both buyer and seller.
The negotiation should be led by a member of the procurement team that has
the authority to sign contracts. The project manager and other members of the
project management team may be present during negotiation to provide
assistance as needed.
12.2.3 CONDUCT PROCUREMENTS: OUTPUTS
12.2.3.1 SELECTED SELLERS
The selected sellers are those who have been judged to be in a competitive
range based on the outcome of the proposal or bid evaluation. Final approval of
complex, high-value, high-risk procurements will generally require
organizational senior management approval prior to award.
12.2.3.2 AGREEMENTS
A contract is a mutually binding agreement that obligates the seller to provide
the specified products, services, or results; obligates the buyer to compensate the
seller; and represents a legal relationship that is subject to remedy in the courts.
The major components in an agreement document will vary, and may include
but are not limited to:
Procurement statement of work or major deliverables;
Schedule, milestones, or date by which a schedule is required;
Performance reporting;
Pricing and payment terms;
Inspection, quality, and acceptance criteria;
Warranty and future product support;
Incentives and penalties;
Insurance and performance bonds;
Subordinate subcontractor approvals;
General terms and conditions;
Change request handling; and
Termination clause and alternative dispute resolution mechanisms.
12.2.3.3 CHANGE REQUESTS
Described in Section 4.3.3.4. Change requests to the project management
plan, its subsidiary plans, and other components are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
12.2.3.4 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may require a change request for the project management
plan include but are not limited to:
Requirements management plan. Described in Section 5.1.3.2. There
may be changes to project requirements due to changes identified by
sellers.
Quality management plan. Described in Section 8.1.3.1. Sellers may
offer alternative quality standards or alternative solutions that impact
the quality approaches defined in the quality management plan.
Communications management plan. Described in Section 10.1.3.1. As
sellers are hired, the communications management plan is updated to
incorporate their communications needs and approaches.
Risk management plan. Described in Section 11.1.3.1. Each agreement
and seller has its own set of risks that may require updates to the risk
management plan. Specific risks are incorporated into the risk register.
Procurement management plan. Described in Section 12.1.3.1.
Updates may be required depending on the results of the contracting
and negotiations processes.
Scope baseline. Described in Section 5.4.3.1. The project WBS and
deliverables documented in the scope baseline are considered when
performing procurement activities. Any one or all of these may change
during the procurement process.
Schedule baseline. Described in Section 6.5.3.1. If there are delivery
changes created by sellers that impact overall project schedule
performance, the baseline schedule may need to be updated and
approved to reflect the current expectations.
Cost baseline. Described in Section 7.3.3.1. Contractor and materials
prices can change frequently during the delivery of a project. These
changes can occur because of fluctuating materials and labor prices
created by the external economic environment and need to be
incorporated into the cost baseline.
12.2.3.5 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with information on challenges encountered
while conducting procurements and how they could have been avoided
as well as approaches that worked well.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may include:
Technical requirements that the seller is required to satisfy, and
Requirements with contractual and legal implications that may
include health, safety, security, performance, environmental,
insurance, intellectual property rights, equal employment
opportunity, licenses, permits, and other nontechnical requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. As
sellers are incorporated into the project's plan, the requirements
register and the traceability matrix may change depending on the
capabilities of the specific seller.
Resource calendars. Described in Section 9.2.1.2. Schedule resource
calendars may need to be updated depending on the availabilities of
the sellers.
Risk register. Described in Section 11.2.3.1. Each approved seller
comes with its own unique set of risks, depending on the seller's
organization, the duration of the contract, the external environment,
the project delivery method, the type of contracting vehicle chosen,
and the final agreed-upon price. Changes are made to the risk register
during the contracting process, which reflect the specific risks of each
seller.
Stakeholder register. Described in Section 13.1.3.1. This document
contains all the details about the identified stakeholders. The
stakeholder register is updated as agreements are made with specific
sellers.
12.2.3.6 ORGANIZATIONAL PROCESS ASSETS UPDATES
Elements of the organizational process assets that can be updated as a result of
the Conduct Procurements process can include:
Listings of prospective and prequalified sellers; and
Information on relevant experience with sellers, both good and bad.
12.3 CONTROL PROCUREMENTS
Control Procurements is the process of managing procurement relationships;
monitoring contract performance, and making changes and corrections as
appropriate; and closing out contracts. The key benefit of this process is that it
ensures that both the seller's and buyer's performance meet the project's
requirements according to the terms of the legal agreement. This process is
performed throughout the project as needed. The inputs, tools and techniques,
and outputs of this process are depicted in Figure 12-6. Figure 12-7 depicts the
data flow diagram of the process.
Both the buyer and the seller administer the procurement contract for similar
purposes. Each is required to ensure that both parties meet their contractual
obligations and that their own legal rights are protected. The legal nature of the
relationship makes it imperative that the project management team is aware of
the implications of actions taken when controlling any procurement. On larger
projects with multiple providers, a key aspect of contract administration is
managing communication among the various providers.
Because of the legal aspect, many organizations treat contract administration
as an organizational function that is separate from the project. While a
procurement administrator may be on the project team, this individual typically
reports to a supervisor from a different department.
Control Procurements includes application of the appropriate project
management processes to the contractual relationship(s) and integration of the
outputs from these processes into the overall management of the project. This
integration often occurs at multiple levels when there are multiple sellers and
multiple products, services, or results involved.
Administrative activities may include:
Collection of data and managing project records, including
maintenance of detailed records of physical and financial performance
and establishment of measurable procurement performance indicators;
Refinement of procurement plans and schedules;
Set up for gathering, analyzing, and reporting procurement-related
project data and preparation of periodic reports to the organization;
Monitoring the procurement environment so that implementation can
be facilitated or adjustments made; and
Payment of invoices.
The quality of the controls, including the independence and credibility of
procurement audits, is critical to the reliability of the procurement system. The
organization's code of ethics, its legal counsel, and external legal advisory
arrangements including any ongoing anti-corruption initiatives can contribute to
proper procurement controls.
Control Procurements has a financial management component that involves
monitoring payments to the seller. This ensures that payment terms defined
within the contract are met and that compensation is linked to the seller's
progress as defined in the contract. A principal concern when making payments
is to ensure there is a close relationship of payments made to the work
accomplished. A contract that requires payments linked to project output and
deliverables rather than inputs such as labor hours has better controls.
Agreements can be amended at any time prior to contract closure by mutual
consent, in accordance with the change control terms of the agreement. Such
amendments are typically captured in writing.
12.3.1 CONTROL PROCUREMENTS: INPUTS
12.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Requirements management plan. Described in Section 5.1.3.2. The
requirements management plan describes how contractor requirements
will be analyzed, documented, and managed.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan describes how risk activities created by sellers will
be structured and performed for the project.
Procurement management plan. Described in Section 12.1.3.2. The
procurement management plan contains the activities to be performed
during the Control Procurement process.
Change management plan. Described in Section 4.2.3.1. The change
management plan contains information about how seller-created
changes will be processed.
Schedule baseline. Described in Section 6.5.3.1. If there are slippages
created by sellers that impact overall project performance, the schedule
may need to be updated and approved to reflect the current
expectations.
12.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs to this process include but
are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log
documents the assumptions that have been made during the
procurement process.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied further along in the project to
improve contractor performance and the procurement process.
Milestone list. Described in Section 6.2.3.3. This list of major
milestones shows when the sellers are expected to deliver their results.
Quality reports. Described in Section 8.2.3.1. The quality reports can
identify seller processes, procedures, or products that are out of
compliance.
Requirements documentation. Described in Section 5.2.3.1.
Requirements documentation may include:
Technical requirements the seller is required to satisfy, and
Requirements with contractual and legal implications that may
include health, safety, security, performance, environmental,
insurance, intellectual property rights, equal employment
opportunity, licenses, permits, and other nontechnical requirements.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix links product requirements from their
origin to the deliverables that satisfy them.
Risk register. Described in Section 11.2.3.1. Each approved seller
comes with its own unique set of risks, depending on the seller's
organization, the duration of the contract, the external environment,
the project delivery method, the type of contracting vehicle chosen,
and the final agreed-upon price.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register includes information about identified stakeholders, including
contracted team members, selected sellers, contracting officers, and
other stakeholders who are involved in procurements.
12.3.1.3 AGREEMENTS
Described in Section 12.2.3.2. Agreements are understandings between
parties, including understanding of the duties of each party. The relevant
agreements are reviewed to verify terms and conditions are met.
12.3.1.4 PROCUREMENT DOCUMENTATION
Procurement documentation contains complete supporting records for
administration of the procurement processes. Procurement documentation
includes the statement of work, payment information, contractor work
performance information, plans, drawings, and other correspondence.
12.3.1.5 APPROVED CHANGE REQUESTS
Described in Section 4.6.3.1. Approved change requests can include
modifications to the terms and conditions of the contract, including the
procurement statement of work (SOW), pricing, and descriptions of the
products, services, or results to be provided. All procurement-related changes are
formally documented in writing and approved before being implemented
through the Control Procurements process. In complex projects and programs,
change requests may come from sellers involved with the project that can
influence other involved sellers. The project should have the capability of
identifying, communicating, and resolving changes that impact the work of
multiple sellers.
12.3.1.6 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains seller data on
project status such as technical performance; activities that have started, are in
progress, or have completed; and costs that have been incurred or committed.
Work performance data can also include information on the seller invoices that
have been paid.
12.3.1.7 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Control
Procurements process include but are not limited to:
Contract change control system,
Marketplace conditions,
Financial management and accounts payable system, and
Buying organization's code of ethics.
12.3.1.8 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Control Procurements
process include but are not limited to, procurement policies.
12.3.2 CONTROL PROCUREMENTS: TOOLS AND
TECHNIQUES
12.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1 Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Relevant functional areas such as finance, engineering, design,
development, supply chain management, etc.;
Laws, regulations, and compliance requirements; and
Claims administration.
12.3.2.2 CLAIMS ADMINISTRATION
Contested changes and potential constructive changes are those requested
changes where the buyer and seller cannot reach an agreement on compensation
for the change or cannot agree that a change has occurred. These contested
changes are called claims. When they cannot be resolved, they become disputes
and finally appeals. Claims are documented, processed, monitored, and managed
throughout the contract life cycle, usually in accordance with the terms of the
contract. If the parties themselves do not resolve a claim, it may have to be
handled in accordance with alternative dispute resolution (ADR) typically
following procedures established in the contract. Settlement of all claims and
disputes through negotiation is the preferred method.
12.3.2.3 DATA ANALYSIS
Data analysis techniques that can be used to monitor and control procurements
include but are not limited to:
Performance Reviews. Performance reviews for contracts measure,
compare, and analyze quality, resource, schedule, and cost
performance against the agreement. This includes identifying work
packages that are ahead or behind schedule, over or under budget, or
have resource or quality issues.
Earned Value Analysis (EVA). Described in Section 7.4.2.2. Schedule
and cost variances along with schedule and cost performance indexes
are calculated to determine the degree of variance from target.
Trend Analysis. Described in Section 4.5.2.2. Trend analysis can
develop a forecast estimate at completion (EAC) for cost performance
to see if performance is improving or deteriorating. See 7.4.2.2 for
more detail on EAC methods.
12.3.2.4 INSPECTION
An inspection is a structured review of the work being performed by the
contractor. This may involve a simple review of the deliverables or an actual
physical review of the work itself. On a construction/engineering/infrastructure
project, inspections involve walkthroughs of the site by both the buyer and the
contractor to ensure a mutual understanding of the work in progress.
12.3.2.5 AUDITS
Audits are described in Section 8.2.2.5. Audits are a structured review of the
procurement process. Rights and obligations related to audits should be
described in the procurement contract. Resulting audit observations should be
brought to the attention of the buyer's project manager and the seller's project
manager for adjustments to the project, when necessary.
12.3.3 CONTROL PROCUREMENTS: OUTPUTS
12.3.3.1 CLOSED PROCUREMENTS
The buyer, usually through its authorized procurement administrator, provides
the seller with formal written notice that the contract has been completed.
Requirements for formal procurement closure are usually defined in the terms
and conditions of the contract and are included in the procurement management
plan. Typically, all deliverables should have been provided on time and meet
technical and quality requirements, there should be no outstanding claims or
invoices, and all final payments should have been made. The project
management team should have approved all deliverables prior to closure.
12.3.3.2 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information on how a seller is performing by comparing the deliverables
received, the technical performance achieved, and the costs incurred and
accepted against the SOW budget for the work performed.
12.3.3.3 PROCUREMENT DOCUMENTATION UPDATES
Procurement documentation that may be updated includes the contract with all
supporting schedules, requested unapproved contract changes, and approved
change requests. Procurement documentation also includes any seller-developed
technical documentation and other work performance information such as
deliverables, seller performance reports and warranties, financial documents
including invoices and payment records, and the results of contract-related
inspections.
12.3.3.4 CHANGE REQUESTS
Described in Section 4.3.3.4. Change requests to the project management
plan, its subsidiary plans, and other components such as the cost baseline,
schedule baseline, and procurement management plan, may result from the
Control Procurements process. Change requests are processed for review and
disposition through the Perform Integrated Change Control process (Section
4.6).
Requested but unresolved changes can include direction provided by the buyer
or actions taken by the seller, which the other party considers a constructive
change to the contract. Since any of these constructive changes may be disputed
by one party and can lead to a claim against the other party, such changes are
uniquely identified and documented by project correspondence.
12.3.3.5 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components that may require a
change request for the project management plan include but are not limited to:
Risk management plan. Described in Section 11.1.3.1. Each agreement
and seller has its own set of risks that may require updates to the risk
management plan. If significant unexpected risks occur during the
execution of the contract, the risk management plan may require
updating. Specific risks are incorporated into the risk register.
Procurement management plan. Described in Section 12.1.3.1. The
procurement management plan contains the activities to be undertaken
during the procurement process. Updates may be required depending
on the results of the performance of the sellers during execution of the
work.
Schedule baseline. Described in Section 6.5.3.1. If there are significant
schedule changes created by sellers that impact overall project
schedule performance, the baseline schedule may need to be updated
and approved to reflect the current expectations. The buyer should be
aware of any cascading impacts of schedule delays created by a seller
that impact other sellers.
Cost baseline. Described in Section 7.3.3.1. Contractor and material
costs can change frequently during the delivery of a project. These
changes can occur because of fluctuating materials and labor prices
created by the external economic environment and need to be
incorporated into the cost baseline.
12.3.3.6 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register can be updated with techniques that were effective in
maintaining the scope, schedule, and cost of the procured items.
Where variances occurred, the register should show the corrective
actions that were used to respond to variances and how effective those
actions were. If there are any claims, information should be
documented to avoid recurrences. Additional information on how to
improve the procurement process can also be recorded.
Resource requirements. Described in Section 9.2.3.1. As the work
progresses by the contractors, there may be changes to the resource
requirements resulting from work being done that is not in accordance
with the planned work schedule.
Requirements traceability matrix. Described in Section 5.2.3.2. The
requirements traceability matrix is updated with information on
requirements that have been satisfied.
Risk register. Described in Section 11.2.3.1. Each approved seller
comes with its own unique set of risks, depending on the seller's
organization, the duration of the contract, the external environment,
the project delivery method, the type of contracting vehicle chosen,
and the final agreed-upon price. Changes are made to the risk register
during the execution of the project, as early risks may no longer be
applicable and new risks occur.
Stakeholder register. Described in Section 13.1.3.1. As the work
progresses through the execution phase, the contractors and suppliers
may change. These changes should be reflected in the stakeholder
register.
12.3.3.7 ORGANIZATIONAL PROCESS ASSETS UPDATES
Organizational process assets that can be updated as a result of the Control
Procurements process include but are not limited to:
Payment schedules and requests. All payments should be made in
accordance with the procurement contract terms and conditions.
Seller performance evaluation documentation. Seller performance
evaluation documentation is prepared by the buyer and documents the
seller's ability to continue to perform work on the current contract,
indicates whether the seller can be allowed to perform work on future
projects, or rates how well the seller is performing the project work or
has performed in the past.
Prequalified seller lists updates. Prequalified seller lists are lists of
potential sellers who are previously qualified (approved). These lists
will be updated according to the Procurement Control process
outcomes because sellers could be disqualified and removed from the
lists based on poor performance.
Lessons learned repository. Lessons learned should be archived in the
lessons learned repository to improve procurements on future projects.
At the end of a contract, the actual results of the procurement are
compared with the projected results in the original procurement
management plan. These lessons learned state whether the project
objectives were achieved and, if not, provides the reasons they were
not.
Procurement file. A complete set of indexed contract documentation,
including the closed contract, is prepared for inclusion with the final
project files.
13
PROJECT STAKEHOLDER MANAGEMENT
Project Stakeholder Management includes the processes required to identify
the people, groups, or organizations that could impact or be impacted by the
project, to analyze stakeholder expectations and their impact on the project, and
to develop appropriate management strategies for effectively engaging
stakeholders in project decisions and execution. The processes support the work
of the project team to analyze stakeholder expectations, assess the degree to
which they impact or are impacted by the project, and develop strategies to
effectively engage stakeholders in support of project decisions and the planning
and execution of the work of the project.
The Project Stakeholder Management processes are:
13.1 Identify Stakeholders—The process of identifying project stakeholders
regularly and analyzing and documenting relevant information regarding their
interests, involvement, interdependencies, influence, and potential impact on
project success.
13.2 Plan Stakeholder Engagement—The process of developing approaches to
involve project stakeholders based on their needs, expectation, interests, and
potential impact on the project.
13.3 Manage Stakeholder Engagement—The process of communicating and
working with stakeholders to meet their needs and expectations, address issues,
and foster appropriate stakeholder engagement involvement.
13.4 Monitor Stakeholder Engagement—The process of monitoring project
stakeholder relationships and tailoring strategies for engaging stakeholders
through the modification of engagement strategies and plans.
Figure 13-1 provides an overview of the Project Stakeholder Management
processes. The Project Stakeholder Management processes are presented as
discrete processes with defined interfaces while, in practice, they overlap and
interact in ways that cannot be completely detailed in the PMBOK® Guide.
KEY CONCEPTS FOR PROJECT STAKEHOLDER MANAGEMENT
Every project has stakeholders who are impacted by or can impact the project
in a positive or negative way. Some stakeholders may have a limited ability to
influence the project's work or outcomes; others may have significant influence
on the project and its expected outcomes. Academic research and analyses of
high-profile project disasters highlight the importance of a structured approach
to the identification, prioritization, and engagement of all stakeholders. The
ability of the project manager and team to correctly identify and engage all
stakeholders in an appropriate way can mean the difference between project
success and failure. To increase the chances of success, the process of
stakeholder identification and engagement should commence as soon as possible
after the project charter has been approved, the project manager has been
assigned and the team begins to form.
Stakeholder satisfaction should be identified and managed as a project
objective. The key to effective stakeholder engagement is a focus on continuous
communication with all stakeholders, including team members, to understand
their needs and expectations, address issues as they occur, manage conflicting
interests, and foster appropriate stakeholder engagement in project decisions and
activities.
The process of identifying and engaging stakeholders for the benefit of the
project is iterative. Although the processes in Project Stakeholder Management
are described only once, the activities of identification, prioritization, and
engagement should be reviewed and updated routinely, and at least at the
following times when:
The project moves through different phases in its life cycle,
Current stakeholders are no longer involved in the work of the project
or new stakeholders become members of the project's stakeholder
community, or
There are significant changes in the organization or the wider
stakeholder community.
TRENDS AND EMERGING PRACTICES IN PROJECT STAKEHOLDER
ENGAGEMENT
Broader definitions of stakeholders are being developed that expand the
traditional categories of employees, suppliers, and shareholders to include
groups such as regulators, lobby groups, environmentalists, financial
organizations, the media, and those who simply believe they are stakeholders—
they perceive that they will be affected by the work or outcomes of the project.
Trends and emerging practices for Project Stakeholder Management include
but are not limited to:
Identifying all stakeholders, not just a limited set;
Ensuring that all team members are involved in stakeholder
engagement activities;
Reviewing the stakeholder community regularly, often in parallel with
reviews of individual project risks;
Consulting with stakeholders who are most affected by the work or
outcomes of the project through the concept of co-creation. Co-
creation places greater emphasis on including affected stakeholders in
the team as partners; and
Capturing the value of effective stakeholder engagement, both positive
and negative. Positive value can be based on the consideration of
benefits derived from higher levels of active support from
stakeholders, particularly powerful stakeholders. Negative value can
be derived by measuring the true costs of not engaging stakeholders
effectively, leading to product recalls or loss of organizational or
project reputation.
TAILORING CONSIDERATIONS
Because each project is unique, the project manager may need to tailor the
way Project Stakeholder Management processes are applied. Considerations for
tailoring include but are not limited to:
Stakeholder diversity. How many stakeholders are there? How diverse
is the culture within the stakeholder community?
Complexity of stakeholder relationships. How complex are the
relationships within the stakeholder community? The more networks a
stakeholder or stakeholder group participates in, the more complex the
networks of information and misinformation the stakeholder may
receive.
Communication technology. What communication technology is
available? What support mechanisms are in place to ensure that best
value is achieved from the technology?
CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
Projects experiencing a high degree of change require active engagement and
participation with project stakeholders. To facilitate timely, productive
discussion and decision making, adaptive teams engage with stakeholders
directly rather than going through layers of management. Often the client, user,
and developer exchange information in a dynamic co-creative process that leads
to more stakeholder involvement and higher satisfaction. Regular interactions
with the stakeholder community throughout the project mitigate risk, build trust,
and support adjustments earlier in the project cycle, thus reducing costs and
increasing the likelihood of success for the project.
In order to accelerate the sharing of information within and across the
organization, agile methods promote aggressive transparency. The intent of
inviting any stakeholders to project meetings and reviews or posting project
artifacts in public spaces is to surface as quickly as possible any misalignment,
dependency, or other issue related to the changing project.
13.1 IDENTIFY STAKEHOLDERS
Identify Stakeholders is the process of identifying project stakeholders
regularly and analyzing and documenting relevant information regarding their
interests, involvement, interdependencies, influence, and potential impact on
project success. The key benefit of this process is that it enables the project team
to identify the appropriate focus for engagement of each stakeholder or group of
stakeholders. This process is performed periodically throughout the project as
needed. The inputs, tools and techniques, and outputs of the process are depicted
in Figure 13-2. Figure 13-3 depicts the data flow diagram for the process.
This process frequently occurs for the first time in a project either prior to or
at the same time the project charter is developed and approved. It is repeated as
necessary, but should be performed at the start of each phase and when a
significant change in the project or the organization occurs. Each time the
identification process is repeated, the project management plan components and
project documents should be consulted to identify relevant project stakeholders.
13.1.1 IDENTIFY STAKEHOLDERS: INPUTS
13.1.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter identifies the key stakeholder
list. It may also contain information about the responsibilities of the
stakeholders.
13.1.1.2 BUSINESS DOCUMENTS
In the first iteration of the Identify Stakeholders process, the business case and
the benefits management plan are sources of information about the project's
stakeholders.
Business case. Described in Section 1.2.6.1. The business case
identifies the project objectives and identifies an initial list of
stakeholders affected by the project.
Benefits management plan. Described in Section 1.2.6.2. The benefits
management plan describes the expected plan for realizing the benefits
claimed in the business case. It may identify the individuals and
groups that will benefit from the delivery of the outcomes of the
project and are thus considered as stakeholders.
13.1.1.3 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. The project management plan is not available
when initially identifying stakeholders; however, once it has been developed,
project management plan components include but are not limited to:
Communications management plan. Described in Section 10.1.3.1.
Communications and stakeholder engagement are strongly linked.
Information included in the communications management plan is a
source of knowledge about the project's stakeholders.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan identifies the management strategies and
actions required to effectively engage stakeholders.
13.1.1.4 PROJECT DOCUMENTS
It is unlikely that any project documents will be an input for the initial
stakeholder identification. However, stakeholder identification occurs
throughout the project. Once the project is past the startup phase, more
documents become available and are used throughout the project. Project
documents that can be considered as inputs for this process include but are not
limited to:
Change log. Described in Section 4.6.3.3. The change log may
introduce a new stakeholder or change the nature of an existing
stakeholder's relationship to the project.
Issue log. Described in Section 4.3.3.3. The issue log records issues
that may introduce new stakeholders to the project or change the type
of participation of existing stakeholders.
Requirements documentation. Described in Section 5.2.3.1.
Requirements can provide information on potential stakeholders.
13.1.1.5 AGREEMENTS
Described in Section 12.2.3.2. The parties of an agreement are project
stakeholders. The agreement can contain references to additional stakeholders.
13.1.1.6 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Identify
Stakeholders process include but are not limited to:
Organizational culture, political climate, and governance framework;
Government or industry standards (regulations, product standards, and
codes of conduct);
Global, regional, or local trends and practices or habits; and
Geographic distribution of facilities and resources.
13.1.1.7 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Identify Stakeholders
process include but are not limited to:
Stakeholder register templates and instructions,
Stakeholder registers from previous projects, and
Lessons learned repository with information about the preferences,
actions, and involvement of stakeholders.
13.1.2 IDENTIFY STAKEHOLDERS: TOOLS AND TECHNIQUES
13.1.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Understanding the politics and power structures in the organization,
Knowledge of the environment and culture of the organization and
other affected organizations including customers and the wider
environment,
Knowledge of the industry or type of project deliverable, and
Knowledge of individual team member contributions and expertise.
13.1.2.2 DATA GATHERING
Data-gathering techniques that can be used for this process include but are not
limited to:
Questionnaires and surveys. Described in Section 5.2.2.2.
Questionnaires and surveys can include one-on-one reviews, focus
group sessions, or other mass information collection techniques.
Brainstorming. Described in Section 4.1.2.2. Brainstorming as used to
identify stakeholders can include both brainstorming and brain writing.
Brainstorming. A general data-gathering and creativity technique
that elicits input from groups such as team members or subject matter
experts.
Brain writing. A refinement of brainstorming that allows individual
participants time to consider the question(s) individually before the
group creativity session is held. The information can be gathered in
face-to-face groups or using virtual environments supported by
technology.
13.1.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Stakeholder analysis. Stakeholder analysis results in a list of
stakeholders and relevant information such as their positions in the
organization, roles on the project, “stakes,” expectations, attitudes
(their levels of support for the project), and their interest in
information about the project. Stakeholders’ stakes can include but are
not limited to a combination of:
Interest. A person or group can be affected by a decision related to
the project or its outcomes.
Rights (legal or moral rights). Legal rights, such as occupational
health and safety, may be defined in the legislation framework of a
country. Moral rights may involve concepts of protection of historical
sites or environmental sustainability.
Ownership. A person or group has a legal title to an asset or a
property.
Knowledge. Specialist knowledge, which can benefit the project
through more effective delivery of project objectives, organizational
outcomes, or knowledge of the power structures of the organization.
Contribution. Provision of funds or other resources, including human
resources, or providing support for the project in more intangible
ways, such as advocacy in the form of promoting the objectives of
the project or acting as a buffer between the project and the power
structures of the organization and its politics.
Document analysis. Described in Section 5.2.2.3. Assessing the
available project documentation and lessons learned from previous
projects to identify stakeholders and other supporting information.
13.1.2.4 DATA REPRESENTATION
A data representation technique that may be used in this process includes but
is not limited to stakeholder mapping/representation. Stakeholder mapping and
representation is a method of categorizing stakeholders using various methods.
Categorizing stakeholders assists the team in building relationships with the
identified project stakeholders. Common methods include:
Power/interest grid, power/influence grid, or impact/influence grid.
Each of these techniques supports a grouping of stakeholders
according to their level of authority (power), level of concern about the
project's outcomes (interest), ability to influence the outcomes of the
project (influence), or ability to cause changes to the project's planning
or execution. These classification models are useful for small projects
or for projects with simple relationships between stakeholders and the
project, or within the stakeholder community itself.
Stakeholder cube. This is a refinement of the grid models previously
mentioned. This model combines the grid elements into a three-
dimensional model that can be useful to project managers and teams in
identifying and engaging their stakeholder community. It provides a
model with multiple dimensions that improves the depiction of the
stakeholder community as a multidimensional entity and assists with
the development of communication strategies.
Salience model. Describes classes of stakeholders based on
assessments of their power (level of authority or ability to influence
the outcomes of the project), urgency (need for immediate attention,
either time-constrained or relating to the stakeholders’ high stake in
the outcome), and legitimacy (their involvement is appropriate). There
is an adaptation of the salience model that substitutes proximity for
legitimacy (applying to the team and measuring their level of
involvement with the work of the project). The salience model is
useful for large complex communities of stakeholders or where there
are complex networks of relationships within the community. It is also
useful in determining the relative importance of the identified
stakeholders.
Directions of influence. Classifies stakeholders according to their
influence on the work of the project or the project team itself.
Stakeholders can be classified in the following ways:
Upward (senior management of the performing organization or
customer organization, sponsor, and steering committee),
Downward (the team or specialists contributing knowledge or skills
in a temporary capacity),
Outward (stakeholder groups and their representatives outside the
project team, such as suppliers, government departments, the public,
end-users, and regulators), or
Sideward (the peers of the project manager, such as other project
managers or middle managers who are in competition for scarce
project resources or who collaborate with the project manager in
sharing resources or information).
Prioritization. Prioritizing stakeholders may be necessary for projects
with a large number of stakeholders, where the membership of the
stakeholder community is changing frequently, or when the
relationships between stakeholders and the project team or within the
stakeholder community are complex.
13.1.2.5 MEETINGS
Meetings are used to develop an understanding of significant project
stakeholders. They can take the form of facilitation workshops, small group
guided discussions, and virtual groups using electronics or social media
technologies to share ideas and analyze data.
13.1.3 IDENTIFY STAKEHOLDERS: OUTPUTS
13.1.3.1 STAKEHOLDER REGISTER
The main output of the Identify Stakeholders process is the stakeholder
register. This document contains information about identified stakeholders that
includes but is not limited to:
Identification information. Name, organizational position, location and
contact details, and role on the project.
Assessment information. Major requirements, expectations, potential
for influencing project outcomes, and the phase of the project life
cycle where the stakeholder has the most influence or impact.
Stakeholder classification. Internal/external,
impact/influence/power/interest, upward/downward/outward/sideward,
or any other classification model chosen by the project manager.
13.1.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. During the first iteration of identifying
stakeholders, there will not be any change requests. As stakeholder identification
continues throughout the project, new stakeholders, or new information about
stakeholders, may result in a change request to the product, project management
plan, or project documents.
Change requests are processed for review and disposition through the Perform
Integrated Change Control (Section 4.6) process.
13.1.3.3 PROJECT MANAGEMENT PLAN UPDATES
When stakeholders are identified at the very beginning of a project, there will
not be updates to the project management plan. As the project progresses, any
change to the project management plan goes through the organization's change
control process via a change request. Components that may require a change
request for the project management plan include but are not limited to:
Requirements management plan. Described in Section 5.1.1.2. Newly
identified stakeholders can impact how requirements activities will be
planned, tracked, and reported.
Communications management plan. Described in Section 10.1.3.1.
Stakeholder communication requirements and agreed-upon
communications strategies are recorded in the communications
management plan.
Risk management plan. Described in Section 11.1.3.1. Where
stakeholder communication requirements and agreed-upon
communications strategies affect the approach to managing risk on the
project, this is reflected in the risk management plan.
Stakeholder engagement plan. Described in Section 13.2.3.1. Agreed-
upon communications strategies for identified stakeholders are
recorded in the stakeholder engagement plan.
13.1.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Assumption log. Described in Section 4.1.3.2. Much of the
information about the relative power, interest, and engagement of
stakeholders is based on assumptions. This information is entered into
the assumption log. Additionally, any constraints associated with
interacting with specific stakeholders are entered as well.
Issue log. Described in Section 4.3.3.3. New issues raised as a result of
this process are recorded in the issue log.
Risk register. Described in Section 11.2.3.1. New risks identified
during this process are recorded in the risk register and managed using
the risk management processes.
13.2 PLAN STAKEHOLDER ENGAGEMENT
Plan Stakeholder Engagement is the process of developing approaches to
involve project stakeholders based on their needs, expectations, interests, and
potential impact on the project. The key benefit is that it provides an actionable
plan to interact effectively with stakeholders. This process is performed
periodically throughout the project as needed.
The inputs, tools and techniques, and outputs of the process are depicted in
Figure 13-4. Figure 13-5 depicts the data flow diagram for the process.
An effective plan that recognizes the diverse information needs of the project's
stakeholders is developed early in the project life cycle and is reviewed and
updated regularly as the stakeholder community changes. The first version of the
stakeholder engagement plan is developed after the initial stakeholder
community has been identified by the Identify Stakeholder process. The
stakeholder engagement plan is updated regularly to reflect changes to the
stakeholder community. Typical trigger situations requiring updates to the plan
include but are not limited to:
When it is the start of a new phase of the project;
When there are changes to the organization structure or within the
industry;
When new individuals or groups become stakeholders, current
stakeholders are no longer part of the stakeholder community, or the
importance of particular stakeholders to the project's success changes;
and
When outputs of other project process areas, such as change
management, risk management, or issue management, require a review
of stakeholder engagement strategies.
The results of these adjustments may be changes to the relative importance of
the stakeholders who have been identified.
13.2.1 PLAN STAKEHOLDER ENGAGEMENT: INPUTS
13.2.1.1 PROJECT CHARTER
Described in Section 4.1.3.1. The project charter contains information on the
project purpose, objectives, and success criteria that can be taken into
consideration when planning how to engage stakeholders.
13.2.1.2 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan may contain information regarding roles
and responsibilities of the team and other stakeholders listed in the
stakeholder register.
Communications management plan. Described in Section 10.1.3.1.
The communications strategies for stakeholder management and their
implementation plans are both inputs to, and recipients of, information
from processes in Project Stakeholder Management.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan may contain risk thresholds or risk attitudes that can
assist in the selection of the optimal stakeholder engagement strategy
mix.
13.2.1.3 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process, especially
after initial planning has taken place, include but are not limited to:
Assumption log. Described in Section 4.1.3.2. The assumption log
contains information about assumptions and constraints and may be
linked to specific stakeholders.
Change log. Described in Section 4.6.3.3. The change log contains
changes to the original scope of the project. It usually links to specific
stakeholders because they fall into categories of requesting certain
changes, making decisions about change requests, or being impacted
by the implementation of approved changes.
Issue log. Described in Section 4.3.3.3. Managing and resolving issues
contained in the issue log will require additional communications with
the stakeholders affected.
Project schedule. Described in Section 6.5.3.2. The schedule contains
activities that may be linked to specific stakeholders as owners or
executors.
Risk register. Described in Section 11.2.3.1. The risk register contains
the identified risks of the project and usually links them to the specific
stakeholders as either risk owners or as subject to risk impact.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register provides the list of project stakeholders including additional
classification data and other information.
13.2.1.4 AGREEMENTS
Described in Section 12.2.3.2. When planning for the engagement of
contractors and suppliers, coordination usually involves working with the
procurement/contracting group in the organization to ensure contractors and
suppliers are effectively managed.
13.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence Plan Stakeholder
Engagement include but are not limited to:
Organizational culture, political climate, and governance framework;
Personnel administration policies;
Stakeholder risk appetites;
Established communication channels;
Global regional or local trends, practices, or habits; and
Geographic distribution of facilities and resources.
13.2.1.6 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Plan Stakeholder
Engagement process include but are not limited to:
Corporate policies and procedures for social media, ethics, and
security;
Corporate policies and procedures for issue, risk, change, and data
management;
Organizational communication requirements;
Standardized guidelines for development, exchange, storage, and
retrieval of information;
Lessons learned repository with information about the preferences,
actions, and involvement of stakeholders; and
Software tools needed to support effective stakeholder engagement.
13.2.2 PLAN STAKEHOLDER ENGAGEMENT: TOOLS AND
TECHNIQUES
13.2.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Politics and power structures in the organization and outside the
organization,
Environment and culture of the organization and outside the
organization,
Analytical and assessment techniques to be used for stakeholder
engagement processes,
Communication means and strategies, and
Knowledge from previous projects of the characteristics of
stakeholders and stakeholder groups and organizations involved in the
current project that may have been involved in previous similar
projects.
13.2.2.2 DATA GATHERING
A data-gathering technique that can be used for this process includes but is not
limited to benchmarking. Described in Section 8.1.2.2. The results of
stakeholder analysis are compared with information from other organizations or
other projects that are considered to be world class.
13.2.2.3 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Assumption and constraint analysis. Described in Section 11.2.2.3.
Analysis of current assumptions and constraints may be conducted in
order to tailor appropriate engagement strategies.
Root cause analysis. Described in Section 8.2.2.2. Root cause analysis
identifies underlying reasons for the level of support of project
stakeholders in order to select the appropriate strategy to improve their
level of engagement.
13.2.2.4 DECISION MAKING
Decision-making techniques that can be used for this process include but are
not limited to prioritization/ranking. Stakeholder requirements need to be
prioritized and ranked, as do the stakeholders themselves. Stakeholders with the
most interest and the highest influence are often prioritized at the top of the list.
13.2.2.5 DATA REPRESENTATION
Data representation techniques that may be used in this process include but are
not limited to:
Mind mapping. Described in Section 5.2.2.3. Mind mapping is used to
visually organize information about stakeholders and their relationship
to each other and the organization.
Stakeholder engagement assessment matrix. A stakeholder
engagement assessment matrix supports comparison between the
current engagement levels of stakeholders and the desired engagement
levels required for successful project delivery. One way to classify the
engagement level of stakeholders is shown in Figure 13-6. The
engagement level of stakeholders can be classified as follows:
Unaware. Unaware of the project and potential impacts.
Resistant. Aware of the project and potential impacts but resistant to
any changes that may occur as a result of the work or outcomes of the
project. These stakeholders will be unsupportive of the work or
outcomes of the project.
Neutral. Aware of the project, but neither supportive nor
unsupportive.
Supportive. Aware of the project and potential impacts and
supportive of the work and its outcomes.
Leading. Aware of the project and potential impacts and actively
engaged in ensuring that the project is a success.
In Figure 13-6, C represents the current engagement level of each stakeholder
and D indicates the level that the project team has assessed as essential to ensure
project success (desired). The gap between current and desired for each
stakeholder will direct the level of communications necessary to effectively
engage the stakeholder. The closing of this gap between current and desired is an
essential element of monitoring stakeholder engagement.
13.2.2.6 MEETINGS
Meetings are used to discuss and analyze the input data of the stakeholder
engagement planning process and to develop a sound stakeholder engagement
plan.
13.2.3 PLAN STAKEHOLDER ENGAGEMENT: OUTPUTS
13.2.3.1 STAKEHOLDER ENGAGEMENT PLAN
The stakeholder engagement plan is a component of the project management
plan that identifies the strategies and actions required to promote productive
involvement of stakeholders in decision making and execution. It can be formal
or informal and highly detailed or broadly framed, based on the needs of the
project and the expectations of stakeholders.
The stakeholder engagement plan may include but is not limited to specific
strategies or approaches for engaging with individuals or groups of stakeholders.
13.3 MANAGE STAKEHOLDER ENGAGEMENT
Manage Stakeholder Engagement is the process of communicating and
working with stakeholders to meet their needs and expectations, address issues,
and foster appropriate stakeholder involvement. The key benefit of this process
is that it allows the project manager to increase support and minimize resistance
from stakeholders. This process is performed throughout the project. The inputs,
tools and techniques, and outputs of the process are depicted in Figure 13-7.
Figure 13-8 depicts the data flow diagram for the process.
Manage Stakeholder Engagement involves activities such as:
Engaging stakeholders at appropriate project stages to obtain, confirm,
or maintain their continued commitment to the success of the project;
Managing stakeholder expectations through negotiation and
communication;
Addressing any risks or potential concerns related to stakeholder
management and anticipating future issues that may be raised by
stakeholders; and
Clarifying and resolving issues that have been identified.
Managing stakeholder engagement helps to ensure that stakeholders clearly
understand the project goals, objectives, benefits, and risks for the project, as
well as how their contribution will enhance project success.
13.3.1 MANAGE STAKEHOLDER ENGAGEMENT: INPUTS
13.3.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Communications management plan. Described in Section 10.1.3.1.
The communications management plan describes the methods,
formats, and technologies used for stakeholder communication.
Risk management plan. Described in Section 11.1.3.1. The risk
management plan describes the risk categories, risk appetites, and
reporting formats that can be used to manage stakeholder engagement.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan provides guidance and information on
managing stakeholder expectations.
Change management plan. Described in Section 4.2.3.1. The change
management plan describes the process for submitting, evaluating and
implementing changes to the project.
13.3.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs to this process include but
are not limited to:
Change log. Described in Section 4.6.3.3. Change requests and their
status are documented in the change log and communicated to the
appropriate stakeholders.
Issue log. Described in Section 4.3.3.3. Any project or stakeholder
concerns are documented in the issue log, as well as any assigned
action items associated with managing the issue.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project with regard to managing stakeholder engagement
can be applied to later phases in the project to improve the efficiency
and effectiveness of this process.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register provides the list of project stakeholders and any information
needed to execute the stakeholder engagement plan.
13.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Manage
Stakeholder Engagement include but are not limited to:
Organizational culture, political climate, and governance structure of
the organization;
Personnel administration policies;
Stakeholder risk thresholds;
Established communication channels;
Global, regional, or local trends, practices, or habits; and
Geographic distribution of facilities and resources.
13.3.1.4 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Manage Stakeholder
Engagement process include but are not limited to:
Corporate policies and procedures for social media, ethics, and
security;
Corporate policies and procedures for issue, risk, change, and data
management;
Organizational communication requirements;
Standardized guidelines for development, exchange, storage, and
retrieval of information; and
Historical information from previous similar projects.
13.3.2 MANAGE STAKEHOLDER ENGAGEMENT: TOOLS AND
TECHNIQUES
13.3.2.1 EXPERT JUDGMENT
Described in Section 4.1.2.1. Expertise should be considered from individuals
or groups with specialized knowledge or training in the following topics:
Politics and power structures in the organization and outside the
organization;
Environment and culture of the organization and outside the
organization;
Analytical and assessment techniques to be used for stakeholder
engagement processes;
Communication methods and strategies;
Characteristics of stakeholders, stakeholder groups, and organizations
involved in the current project that may have been involved in
previous projects; and
Requirements management, vendor management, and change
management.
13.3.2.2 COMMUNICATION SKILLS
The methods of communication identified for each stakeholder in the
communications management plan are applied during stakeholder engagement
management. The project management team uses feedback to assist in
understanding stakeholder reaction to the various project management activities
and key decisions. Feedback may be collected in the following ways, but not
limited to:
Conversations; both formal and informal,
Issue identification and discussion,
Meetings,
Progress reporting, and
Surveys.
13.3.2.3 INTERPERSONAL AND TEAM SKILLS
Interpersonal and team skills that can be used for this process include but are
not limited to:
Conflict management. Described in Section 9.5.2.1. The project
manager should ensure that conflicts are resolved in a timely manner.
Cultural awareness. Described in Section 10.1.2.6. Cultural awareness
is used to help the project manager and team to communicate
effectively by considering cultural differences and the requirements of
stakeholders.
Negotiation. Described in Section 12.2.2.5. Negotiation is used to
achieve support or agreement that supports the work of the project or
its outcomes and to resolve conflicts within the team or with other
stakeholders.
Observation/conversation. Described in Section 5.2.2.6.
Observation/conversation is used to stay in touch with the work and
attitudes of project team members and other stakeholders.
Political awareness. Described in Section 10.1.2.6. Political awareness
is achieved through understanding the power relationships within and
around the project.
13.3.2.4 GROUND RULES
Ground rules, defined in the team charter set the expected behavior for project
team members, as well as other stakeholders, with regard to stakeholder
engagement.
13.3.2.5 MEETINGS
Described in Section 10.1.2.8. Meetings are used to discuss and address any
issue or concern regarding stakeholder engagement. Types of meetings that are
beneficial as part of this process include but are not limited to:
Decision making,
Issue resolution,
Lessons learned and retrospectives,
Project kick-off,
Sprint planning, and
Status updates.
13.3.3 MANAGE STAKEHOLDER ENGAGEMENT: OUTPUTS
13.3.3.1 CHANGE REQUESTS
Described in Section 4.3.3.4. As a result of managing stakeholder
engagement, changes to the project scope or product scope may emerge. All
change requests are processed for review and disposition through the Perform
Integrated Change Control process (Section 4.6).
13.3.3.2 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may require a change request for the project management
plan include but are not limited to:
Communications management plan. Described in Section 10.1.3.1.
The communications management plan is updated to reflect new or
changed stakeholder requirements.
Stakeholder engagement plan. Described in Section 13.2.3.1. The
stakeholder engagement plan is updated to reflect new or changed
management strategies required to effectively engage stakeholders.
13.3.3.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Change log. Described in Section 4.6.3.3. The change log may be
updated based on any change requests.
Issue log. Described in Section 4.3.3.3. The issue log may be updated
to reflect an update to, or the development of, an issue log entry.
Lessons learned register. Described in Section 4.4.3.1. The lessons
learned register is updated with effective or ineffective approaches to
managing stakeholder engagement so that information can be used in
the current project or future projects.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register may be updated based on new information provided to
stakeholders about resolved issues, approved changes, and general
project status.
13.4 MONITOR STAKEHOLDER ENGAGEMENT
Monitor Stakeholder Engagement is the process of monitoring project
stakeholder relationships and tailoring strategies for engaging stakeholders
through modification of engagement strategies and plans. The key benefit of this
process is that it maintains or increases the efficiency and effectiveness of
stakeholder engagement activities as the project evolves and its environment
changes. This process is performed throughout the project. The inputs, tools and
techniques, and outputs of the process are depicted in Figure 13-9. Figure 13-10
depicts the data flow diagram for the process.
13.4.1 MONITOR STAKEHOLDER ENGAGEMENT: INPUTS
13.4.1.1 PROJECT MANAGEMENT PLAN
Described in Section 4.2.3.1. Project management plan components include
but are not limited to:
Resource management plan. Described in Section 9.1.3.1. The
resource management plan identifies the methods for team member
management.
Communications management plan. Described in Section 10.1.3.1.
The communications management plan describes the plans and
strategies for communication to the project's stakeholders.
Stakeholder engagement plan. Described in Section 13.2.3.1. Defines
the plan for managing stakeholder needs and expectations.
13.4.1.2 PROJECT DOCUMENTS
Project documents that can be considered as inputs for this process include but
are not limited to:
Issue log. Described in Section 4.3.3.3. The issue log documents all
the known issues related to the project and stakeholders.
Lessons learned register. Described in Section 4.4.3.1. Lessons learned
earlier in the project can be applied in later phases of the project to
improve the efficiency and effectiveness of engaging stakeholders.
Project communications. Described in Section 10.2.3.1. These include
the project communications that have been distributed to stakeholders
as defined in the communications management plan and the
stakeholder engagement plan.
Risk register. Described in Section 11.2.3.1. The risk register contains
the identified risks for the project, including those related to
stakeholder engagement and interactions, their categorization, and list
of potential responses.
Stakeholder register. Described in Section 13.1.3.1. The stakeholder
register contains stakeholder information that includes but is not
limited to stakeholder identification, assessment, and classification.
13.4.1.3 WORK PERFORMANCE DATA
Described in Section 4.3.3.2. Work performance data contains data on project
status such as which stakeholders are supportive of the project, and their level
and type of engagement.
13.4.1.4 ENTERPRISE ENVIRONMENTAL FACTORS
The enterprise environmental factors that can influence the Monitor
Stakeholder Engagement process include but are not limited to:
Organizational culture, political climate, and governance framework;
Personnel administration policies;
Stakeholder risk thresholds;
Established communication channels;
Global, regional, or local trends, practices, or habits; and
Geographic distribution of facilities and resources.
13.4.1.5 ORGANIZATIONAL PROCESS ASSETS
The organizational process assets that can influence the Monitor Stakeholder
Engagement process include but are not limited to:
Corporate policies and procedures for social media, ethics, and
security;
Corporate policies and procedures for issue, risk, change, and data
management;
Organizational communication requirement;
Standardized guidelines for development, exchange, storage, and
retrieval of information; and
Historical information from previous projects.
13.4.2 MONITOR STAKEHOLDER ENGAGEMENT: TOOLS
AND TECHNIQUES
13.4.2.1 DATA ANALYSIS
Data analysis techniques that can be used for this process include but are not
limited to:
Alternatives analysis. Described in Section 9.2.2.5. Alternatives
analysis can be used to evaluate options to respond to variances in the
desired results of stakeholder engagement.
Root cause analysis. Described in Section 8.2.2.2. A root cause
analysis can be used to determine the basic underlying reason that
stakeholder engagement is not having the planned effect.
Stakeholder analysis. Described in Section 13.1.2.3. The stakeholder
analysis helps to determine the position of stakeholder groups and
individuals at any particular time in the project.
13.4.2.2 DECISION MAKING
Decision-making techniques that can be used for this process include but are
not limited to:
Multicriteria decision analysis. Described in Section 8.1.2.4. Criteria
for successful stakeholder engagement are prioritized and weighted to
identify the most appropriate choice.
Voting. Described in Section 5.2.2.4. Voting can be used to select the
best response for a variance in stakeholder engagement.
13.4.2.3 DATA REPRESENTATION
A data representation technique used in this process includes but is not limited
to a stakeholder engagement assessment matrix. Described in Section 13.2.2.3.
The stakeholder engagement assessment matrix monitors stakeholder
engagement through tracking changes in level of engagement for each
stakeholder.
13.4.2.4 COMMUNICATION SKILLS
Communication techniques that can be used for this process include but are
not limited to:
Feedback. Described in Section 10.2.2.3. Feedback is used to ensure
that the information to stakeholders is received and understood.
Presentations. Described in Section 10.2.2.3. Presentations provide
clear information to stakeholders.
13.4.2.5 INTERPERSONAL AND TEAM SKILLS
Interpersonal skills to that can be used for this process include but are not
limited to:
Active listening. Described in Section 10.2.2.6. Active listening is
used to reduce misunderstandings and other miscommunication.
Cultural awareness. Described in Section 10.1.2.6. Cultural awareness
and cultural sensitivity help the project manager to plan
communications based on the cultural differences and requirements of
stakeholders and team members.
Leadership. Described in Section 3.4.4. Successful stakeholder
engagement requires strong leadership skills to communicate the
vision and inspire stakeholders to support the work and outcomes of
the project.
Networking. Described in Section 10.2.2.6. Networking ensures access
to information about levels of engagement of stakeholders.
Political awareness. Described in Section 10.1.2.6. Political awareness
is used to understand the strategies of the organization, understand
who wields power and influence in this arena, and to develop an
ability to communicate with these stakeholders.
13.4.2.6 MEETINGS
Types of meetings include status meetings, standup meetings, retrospectives,
and any other meetings as agreed upon in the stakeholder engagement plan to
monitor and assess stakeholder engagement levels. Meetings are no longer
limited by face-to-face or voice-to-voice interactions. While face-to-face
interactions are ideal, they can be expensive. Teleconferencing and technology
bridge the gap and provide numerous ways to connect and conduct a meeting.
13.4.3 MONITOR STAKEHOLDER ENGAGEMENT: OUTPUTS
13.4.3.1 WORK PERFORMANCE INFORMATION
Described in Section 4.5.1.3. Work performance information includes
information about the status of stakeholder engagement, such as the level of
current project support and compared to the desired levels of engagement as
defined in the stakeholder engagement assessment matrix, stakeholder cube, or
other tool.
13.4.3.2 CHANGE REQUESTS
Described in Section 4.3.3.4. A change request may include corrective and
preventive actions to improve the current level of stakeholder engagement.
Change requests are processed for review and disposition through the Perform
Integrated Change Control process (Section 4.6).
13.4.3.3 PROJECT MANAGEMENT PLAN UPDATES
Any change to the project management plan goes through the organization's
change control process via a change request. Components of the project
management plan that may require a change request include but are not limited
to:
Resource management plan. Described in Section 9.1.3.1. Team
responsibilities for stakeholder engagement activities may need to be
updated.
Communications management plan. Described in Section 10.1.3.1.
The project's communication strategies may need to be updated.
Stakeholder engagement plan. Described in Section 13.2.3.1.
Information about the project's stakeholder community may need to be
updated.
13.4.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of carrying out this process
include but are not limited to:
Issue log. Described in Section 4.3.3.3. Information in the issue log
indicates stakeholder attitudes and may need to be updated.
Lessons learned register. Described in Section 4.3.3.1. The lessons
learned register is updated with information on challenges and how
they could have been avoided. It is also updated with approaches that
worked well for engaging stakeholders optimally, and those that did
not work well.
Risk register. Described in Section 11.2.3.1. The risk register may
need to be updated with responses to stakeholder risks.
Stakeholder register. Described in Section 13.1.12-13.1. The
stakeholder register is updated with information as a result of
monitoring stakeholder engagement.
REFERENCES
[1] Project Management Institute. 2017. The Standard for Project
Management. Newtown Square, PA: Author.
[2] Project Management Institute. 2013. The Standard for Portfolio
Management – Third Edition. Newtown Square, PA: Author.
[3] Project Management Institute. 2017. The Standard for Program
Management – Fourth Edition. Newtown Square, PA: Author.
[4] Project Management Institute. 2016. The PMI Lexicon of Project
Management Terms. Available from http://www.pmi.org/lexiconterms
[5] Project Management Institute. Code of Ethics and Professional Conduct.
Available from http://www.pmi.org/codeofethics
[6] Project Management Institute. 2013. Managing Change in Organizations:
A Practice Guide. Newtown Square, PA: Author.
[7] Project Management Institute. 2015. Business Analysis for Practitioners:
A Practice Guide. Newtown Square, PA: Author.
[8] Project Management Institute. 2014. Implementing Organizational
Project Management: A Practice Guide. Newtown Square, PA: Author.
[9] Project Management Institute. 2014. Project Management Institute
Excellence in Practice-Research Collaboration, PMI-RI Standards Program:
Making Sense of PPP Governance, December 19, 2014. Newtown Square,
PA: Author
[10] Project Management Institute. 2016. Governance of Portfolios, Programs,
and Projects: A Practice Guide. Newtown Square, PA: Author.
[11] Project Management Institute. (2013). PMI's Pulse of the Profession®
In-Depth Report: The Competitive Advantage of Effective Talent
Management. Available from http://www.pmi.org
[12] Project Management Institute. 2015. White Paper, Complexity
Management for Projects, Programmes, and Portfolios: An Engineering
Systems Perspective, March 2015. Newtown Square, PA: Author.
[13] Project Management Institute. 2014. Navigating Complexity: A Practice
Guide. Newtown Square, PA: Author.
[14] Project Management Institute. 2016. Requirements Management: A
Practice Guide. Newtown Square, PA: Author.
[15] Project Management Institute. 2006. Practice Standard for Work
Breakdown Structures (WBS). Newtown Square, PA: Author.
[16] Project Management Institute. 2011. Practice Standard for Scheduling –
Second Edition. Newtown Square, PA: Author.
[17] Project Management Institute. 2011. Practice Standard for Earned Value
Management – Second Edition
[18] International Standards Organization. 2015. ISO 9000:2015 Quality
Management Systems—Fundamentals and Vocabulary. Geneva: Author.
Part 2
The Standard for Project Management
1
INTRODUCTION
A standard is a document established by an authority, custom, or general
consent as a model or example. This standard was developed using a process
based on the concepts of consensus, openness, due process, and balance. This
standard describes the processes considered to be good practice on most projects
most of the time. These processes are organized by Process Group. It further
defines key project management concepts including the relationship of project
management to organizational strategy and objectives, governance, portfolio
management, program management, the project environment, and project
success. It also covers information on project life cycles, project stakeholders,
and the role of the project manager. Section 1 discusses key concepts and
provides contextual information about project management. Sections 2 through 6
provide definitions for each of the five Process Groups and describe the
processes within those Process Groups. Sections 2 through 6 also describe the
key benefits, inputs, and outputs for each project management process. This
standard serves as the foundation and framework for A Guide to the Project
Management Body of Knowledge (PMBOK® Guide).1 PMBOK® Guide
expands on the information in this standard by providing a more in-depth
description of the context, environment and influences on project management.
In addition, the PMBOK® Guide provides descriptions of the project
management process inputs and outputs, identifies tools and techniques, and
discusses key concepts and emerging trends associated with each Knowledge
Area.
1.1 PROJECTS AND PROJECT MANAGEMENT
A project is a temporary endeavor undertaken to create a unique product,
service, or result. The temporary nature of projects indicates a definite beginning
and end. Temporary does not necessarily mean a project has a short duration. A
project's end is reached when the objectives have been achieved or when the
project is terminated because its objectives will not or cannot be met, or when
the need for the project no longer exists. The decision to terminate a project
requires approval and authorization by an appropriate authority.
Project management is the application of knowledge, skills, tools, and
techniques to project activities to meet project requirements. Project
management is accomplished through the appropriate application and integration
of the project management processes identified for the project.
Managing a project typically includes but is not limited to:
Identifying project requirements;
Addressing the various needs, concerns, and expectations of
stakeholders;
Establishing and maintaining active communication with stakeholders;
Managing resources; and
Balancing the competing project constraints, which include but are not
limited to:
Scope,
Schedule,
Cost,
Quality,
Resources, and
Risk.
Project circumstances will influence how each project management process is
implemented and how the project constraints are prioritized.
1.2 RELATIONSHIPS AMONG PORTFOLIOS, PROGRAMS, AND
PROJECTS
A portfolio is defined as projects, programs, subsidiary portfolios, and
operations managed in a coordinated manner to achieve strategic objectives.
Portfolio management is the centralized management of one or more portfolios
to achieve strategic objectives. Portfolio management focuses on ensuring the
portfolio is performing consistent with the organization's objectives and
evaluating portfolio components to optimize resource allocation. Portfolios may
include work that is operational in nature.
A program is defined as related projects, subsidiary programs, and program
activities managed in a coordinated manner to obtain benefits not available from
managing them individually. Programs include program related work outside the
scope of the discrete projects in the program. Program management is the
application of knowledge, skills, and principles to a program to achieve the
program objectives and to obtain benefits and control not available by managing
related program components individually. Programs may also include work that
is operational in nature.
Program management supports organizational strategies by authorizing,
changing, or terminating projects and managing their interdependencies.
Managing project interdependencies may include, among other actions, the
following:
Resolving resource constraints and/or conflicts that affect components
within the program;
Aligning with the organization's strategies that impact and affect
program goals and objectives
Managing issues and employing change management within a shared
governance structure;
Addressing project and program risks that can impact one or more
components; and
Managing program benefits realization by effectively analyzing,
sequencing and monitoring component interdependencies.
A project may be managed in three separate scenarios: as a stand-alone project
(outside a portfolio or program); within a program; or within a portfolio. Project
management has interactions with portfolio and program management when a
project is within a portfolio or program.
Figure 1-1 illustrates a sample portfolio structure indicating relationships of
the components, shared resources and stakeholders. The portfolio components
are grouped together in order to facilitate the effective governance and
management of that work and to achieve organizational strategies and priorities.
Organizational and portfolio planning impact the components by means of
prioritization based on risk, funding, and other considerations. This allows
organizations to have an overall view of how the strategic goals are reflected in
the portfolio; institute appropriate portfolio, program, and project governance;
and authorize human, financial, or physical resources. These resources will be
allocated based on expected performance and benefits. Figure 1-1 illustrates that
organizational strategies and priorities are linked and have relationships between
portfolios and programs, between portfolios and projects, and between programs
and individual projects. These relationships are not always strictly hierarchical.
Organizational project management (OPM) is a strategy execution framework
utilizing portfolio, program, and project management. It provides a framework
that enables organizations to consistently and predictably deliver on
organizational strategy, producing better performance, better results, and a
sustainable competitive advantage.
1.3 LINKING ORGANIZATIONAL GOVERNANCE AND
PROJECT GOVERNANCE
There are various types of governance including organizational governance;
organizational project management (OPM) governance; and portfolio, program,
and project governance. Organizational governance is a structured way to
provide direction and control through policies, and processes, to meet strategic
and operational goals. Organizational governance is typically conducted by a
board of directors to ensure accountability, fairness, and transparency to its
stakeholders. Organizational governance principles, decisions, and processes
may influence and impact the governance of portfolios, programs, and projects
in the following ways:
Enforcing legal, regulatory, standards, and compliance requirements,
Defining ethical, social, and environmental responsibilities, and
Specifying operational, legal, and risk policies.
Project governance is the framework, functions, and processes that guide
project management activities in order to create a unique product, service, or
result to meet organizational, strategic, and operational goals. Governance at the
project level includes:
Guiding and overseeing the management of project work;
Ensuring adherence to policies, standards, and guidelines;
Establishing governance roles, responsibilities, and authorities;
Decision-making regarding risk escalations, changes, and resources
(e.g. team, financial, physical, facilities);
Ensuring appropriate stakeholder engagement; and
Monitoring performance.
The project governance framework provides the project stakeholders with
structure, processes, roles, responsibilities, accountabilities, and decision-making
models for managing the project. Elements of a project governance framework
include but are not limited to principles or processes for:
Stage gate or phase reviews;
Identifying, escalating, and resolving risks and issues;
Defining roles, responsibilities, and authorities;
Process for project knowledge management and capturing lessons
learned;
Decision making, problem solving and escalating topics that are
beyond the project manager's authority; and
Reviewing and approving changes to project, and product changes that
are beyond the authority of the project manager.
1.4 PROJECT SUCCESS AND BENEFITS MANAGEMENT
Projects are initiated to realize business opportunities that are aligned with an
organization's strategic goals. Prior to initiating a project, a business case is often
developed to outline the project objectives, the required investment, and
financial and qualitative criteria for project success. The business case provides
the basis to measure success and progress throughout the project life cycle by
comparing the results with the objectives and the identified success criteria.
Projects are typically initiated as a result of one or more of the following
strategic considerations:
Market demand,
Strategic opportunity/business need,
Social need,
Environmental consideration,
Customer request,
Technological advancement,
Legal or regulatory requirement, and
Existing or forecasted problem.
A benefits management plan describes how and when the benefits of the
project will be delivered and how they will be measured. The benefits
management plan may include the following:
Target benefits. The expected tangible and intangible business value to
be gained by the implementation of the product, service, or result.
Strategic alignment. How the project benefits support and align with
the business strategies of the organization.
Timeframe for realizing benefits. Benefits by phase: short term, long
term, and ongoing.
Benefits owner. The accountable person or group that monitors,
records, and reports realized benefits throughout the timeframe
established in the plan.
Metrics. The direct and indirect measurements used to show the
benefits realized.
Risks. Risks associated with achieving target benefits.
The success of the project is measured against the project objectives and
success criteria. In many cases, the success of the product, service, or result is
not known until sometime after the project is complete. For example, an increase
in market share, a decrease in operating expenses, or the success of a new
product may not be known when the project is transitioned to operations. In
these circumstances, the project management office (PMO), portfolio steering
committee, or some other business function within the organization should
evaluate the success at a later date to determine if the outcomes met the business
objectives.
Both the business case and the benefits management plan are developed prior
to the project being initiated. Additionally, both documents are referenced after
the project has been completed. Therefore, they are considered business
documents rather than project documents or components of the project
management plan. As appropriate, these business documents may be inputs to
some of the processes involved in managing the project, such as developing the
project charter.
1.5 THE PROJECT LIFE CYCLE
A project life cycle is the series of phases that a project passes through from
its start to its completion. A project phase is a collection of logically related
project activities that culminates in the completion of one or more deliverables.
The phases can be sequential, iterative, or overlapping. The names, number, and
duration of the project phases are determined by the management and control
needs of the organization(s) involved in the project, the nature of the project
itself, and its area of application. Phases are time bound, with a start and end or
control point (sometimes referred to as a phase review, phase gate, control gate,
or other similar term). At the control point, the project charter and business
documents are reexamined based on the current environment. At that time, the
project's performance is compared to the project management plan to determine
if the project should be changed, terminated, or continue as planned.
The project life cycle can be influenced by the unique aspects of the
organization, industry, development method, or technology employed. While
every project has a start and end, the specific deliverables and work that take
place vary widely depending on the project. The life cycle provides the basic
framework for managing the project, regardless of the specific work involved.
Though projects vary in size and the amount of complexity they contain, a
typical project can be mapped to the following project life cycle structure (see
Figure 1-2):
Starting the project,
Organizing and preparing,
Carrying out the work, and
Closing the project.
A generic life cycle structure typically displays the following characteristics:
Cost and staffing levels are low at the start, increase as the work is
carried out, and drop rapidly as the project draws to a close.
Risk is greatest at the start of the project as illustrated by Figure 1-3.
These factors decrease over the life cycle of the project as decisions
are reached and as deliverables are accepted.
The ability of stakeholders to influence the final characteristics of the
project's product, without significantly impacting cost and schedule, is
highest at the start of the project and decreases as the project
progresses toward completion. Figure 1-3 illustrates the cost of making
changes and correcting errors typically increases substantially as the
project approaches completion.
1.6 PROJECT STAKEHOLDERS
A stakeholder is an individual, group, or organization that may affect, be
affected by, or perceive itself to be affected by a decision, activity, or outcome
of a project. Project stakeholders may be internal or external to the project, they
may be actively involved, passively involved, or unaware of the project. Project
stakeholders may have a positive or negative impact on the project, or be
positively or negatively impacted by the project. Examples of stakeholders
include but are not limited to:
Internal stakeholders:
Sponsor,
Resource manager,
Project management office (PMO),
Portfolio steering committee,
Program manager,
Project managers of other projects, and
Team members.
External stakeholders:
Customers,
End users,
Suppliers,
Shareholders
Regulatory bodies, and
Competitors
Figure 1-4 shows examples of project stakeholders. Stakeholder involvement
may range from occasional contributions in surveys and focus groups to full
project sponsorship that includes the provision of financial, political, or other
types of support. The type and level of project involvement can change over the
course of the project's life cycle. Therefore, successfully identifying, analyzing,
and engaging stakeholders and effectively managing their project expectations
and participation throughout the project life cycle is critical to project success.
1.7 ROLE OF THE PROJECT MANAGER
The project manager is the person assigned by the performing organization to
lead the team responsible for achieving the project objectives. The project
manager's reporting relationships are based on the organizational structure and
project governance.
In addition to any specific technical skills and general management
proficiencies required for the project, project managers should have at least the
following attributes:
Knowledge about project management, the business environment,
technical aspects, and other information needed to manage the project
effectively;
Skills needed to effectively lead the project team, coordinate the work,
collaborate with stakeholders, solve problems, and make decisions;
Abilities to develop and manage scope, schedules, budgets, resources,
risks, plans, presentations, and reports; and
Other attributes required to successfully manage the project, such as
personality, attitude, ethics, and leadership.
Project managers accomplish work through the project team and other
stakeholders. Project managers rely on important interpersonal skills, including,
but not limited to:
Leadership,
Team building,
Motivating,
Communicating,
Influencing,
Decision making,
Political and cultural awareness,
Negotiating,
Facilitating,
Managing conflict, and
Coaching.
The project manager is successful when the project objectives have been
achieved. Another aspect of success is stakeholder satisfaction. The project
manager should address stakeholder needs, concerns and expectations to satisfy
relevant stakeholders. To be successful, the project manager should tailor the
project approach, life cycle, and project management processes to meet the
project and product requirements.
1.8 PROJECT MANAGEMENT KNOWLEDGE AREAS
The Project Management Knowledge Areas are fields or areas of
specialization that are commonly employed when managing projects. A
Knowledge Area is a set of processes associated with a particular topic in project
management. These 10 Knowledge Areas are used on most projects most of the
time. The needs of a specific project may require additional Knowledge Areas.
The 10 Knowledge Areas are:
Project Integration Management. Project Integration Management
includes the processes and activities to identify, define, combine,
unify, and coordinate the various processes and project management
activities within the Project Management Process Groups.
Project Scope Management. Project Scope Management includes the
processes required to ensure that the project includes all the work
required, and only the work required, to complete the project
successfully.
Project Schedule Management. Project Schedule Management
includes the processes required to manage the timely completion of the
project.
Project Cost Management. Project Cost Management includes the
processes involved in planning, estimating, budgeting, financing,
funding, managing, and controlling costs so the project can be
completed within the approved budget.
Project Quality Management. Project Quality Management includes
the processes for incorporating the organization's quality policy
regarding planning, managing, and controlling project and product
quality requirements, in order to meet stakeholders’ expectations.
Project Resource Management. Project Resource Management
includes the processes to identify, acquire, and manage the resources
needed for the successful completion of the project.
Project Communications Management. Project Communications
Management includes the processes required to ensure timely and
appropriate planning, collection, creation, distribution, storage,
retrieval, management, control, monitoring, and ultimate disposition of
project information.
Project Risk Management. Project Risk Management includes the
processes of conducting risk management planning, identification,
analysis, response planning, response implementation, and monitoring
risk on a project.
Project Procurement Management. Project Procurement Management
includes the processes necessary to purchase or acquire products,
services, or results needed from outside the project team.
Project Stakeholder Management. Project Stakeholder Management
includes the processes required to identify the people, groups, or
organizations that could impact or be impacted by the project, to
analyze stakeholder expectations and their impact on the project, and
to develop appropriate management strategies for effectively engaging
stakeholders in project decisions and execution.
1.9 PROJECT MANAGEMENT PROCESS GROUPS
This standard describes the project management processes employed to meet
project objectives. Project management processes are grouped in five Project
Management Process Groups:
Initiating Process Group. The process(es) performed to define a new
project or a new phase of an existing project by obtaining
authorization to start the project or phase. Initiating processes are
described in Section 2.
Planning Process Group. The process(es) required to establish the
scope of the project, refine the objectives, and define the course of
action required to attain the objectives that the project was undertaken
to achieve. Planning processes are described in Section 3.
Executing Process Group. The process(es) performed to complete the
work defined in the project management plan to satisfy the project
requirements. Executing processes are described in Section 4.
Monitoring and Controlling Process Group. The process(es) required
to track, review, and regulate the progress and performance of the
project; identify any areas in which changes to the plan are required;
and initiate the corresponding changes. Monitoring and Controlling
processes are described in Section 5.
Closing Process Group. The process(es) performed to formally
complete or close a project, phase, or contract. Closing processes are
described in Section 6.
These five Process Groups are independent of the application areas, (such as
marketing, information services, or accounting) or industry focus (such as
construction, aerospace, telecommunications). Individual processes in the
Process Groups are often iterated prior to completing a phase or a project. The
number of process iterations and interactions between processes varies based on
the needs of the project. Processes generally fall into one of three categories:
Processes used once or at predefined points in the project. Developing
the project charter and closing the project or phase are examples.
Processes that are performed periodically as needed. Acquiring
resources is performed when resources are needed. Conducting
procurements will be performed prior to needing the procured item.
Processes that are performed continuously throughout the project.
Defining activities may occur throughout the project life cycle,
especially when the project uses rolling wave planning or an adaptive
development approach. Many of the monitoring and control processes
are ongoing from the start of the project, until it is closed out.
The output of one process generally becomes an input to another process or is
a deliverable of the project or project phase. For example, the project
management plan and project documents (e.g., risk register, responsibility
assignment matrix, etc.) produced in the Planning Process Group are provided to
the Executing Process Group where updates are made. Figure 1-4 illustrates an
example of how Process Groups can overlap during a project or phase.
Process Groups are not project phases. If the project is divided into phases, the
processes in the Process Groups interact within each phase. It is possible that all
Process Groups could be represented within a phase, as illustrated in Figure 1-5.
As projects are separated into distinct phases, such as concept development,
feasibility study, design, prototype, build, or test, etc., processes in each of the
Process Groups are repeated as necessary in each phase until the completion
criteria for that phase have been satisfied.
Table 1-1 shows the 49 processes mapped to the Process Groups and
Knowledge Areas.
1.10 ENTERPRISE ENVIRONMENTAL FACTORS AND
ORGANIZATIONAL PROCESS ASSETS
Projects exist and operate in environments that may have an influence on
them. These influences can have a favorable or unfavorable impact on the
project. Two major categories of influences are enterprise environmental factors
(EEFs) and organizational process assets (OPAs).
EEFs originate from the environment outside of the project and often outside
of the enterprise. These factors refer to conditions, which are not under the
control of the project team, that influence, constrain, or direct the project. EEFs
may have an impact at the enterprise, portfolio, program, or project level. (Refer
to Section 2.2 in the PMBOK® Guide for additional information on EEFs.) One
set of such factors are the internal organizational culture, structure and
governance. Examples in this area include but are not limited to: vision, mission,
values, beliefs, cultural norms, hierarchy, and authority relationships.
OPAs are internal to the enterprise. These may arise from the enterprise itself,
a portfolio, a program, another project, or a combination of these. OPAs are the
plans, processes, policies, procedures, and knowledge bases specific to and used
by the performing organization. These assets influence the management of the
project. Examples include but are not limited to: change control procedures,
templates, information from previous projects, and lessons learned repositories.
(Refer to Section 2.3 in the PMBOK® Guide for additional information on
OPAs).
1.11 TAILORING THE PROJECT ARTIFACTS
The term artifact in this context includes project management processes,
inputs, tools, techniques, outputs, EEFs, and OPAs. The project manager and the
project management team select and adapt the appropriate artifacts for use on
their specific project. This selection and adaptation activity is known as
tailoring. Tailoring is necessary because each project is unique; therefore, not
every process, input, tool, technique, or output is required on every project.
The project management plan is the most prevalent artifact. It has many
components, such as the subsidiary management plans, baselines, and a
description of the project life cycle. Subsidiary management plans are plans
associated with a specific aspect or Knowledge Area of the project, for example,
a schedule management plan, risk management plan and change management
plan. Part of tailoring is identifying the project management plan components
needed for a particular project. The project management plan is an input and
project management plan updates are an output of many processes in this
standard. Rather than listing the individual project management plan components
in the input/output tables, examples of the components that may be inputs or
may be updated as outputs are listed beneath the input/output tables for each
process. The possible components are listed as examples only. These inputs and
outputs are not required and are not the only inputs or updates to the project
management plan that a project manager may use in that particular process.
The project management plan is one of the primary project artifacts, but there
are other documents that are not part of the project management plan that are
used to manage the project. These other documents are called project documents.
Similar to project management plan components, project documents needed for a
process will depend on the individual project. The project manager is
accountable for identifying the project documents needed for a process and the
project documents that will be updated as an output of a process. The project
documents listed beneath the input/output tables throughout this standard are
possible examples of project documents, not a comprehensive list.
Table 1-2 is a representative list of project management plan components and
project documents. It is not complete list, but it does provide a representation of
the types of documents that are often used to help manage a project.
Table 1-2. Project Management Plan and Project Documents
Project Management
Plan
Project Documents
1. Scope management plan 1. Activity attributes 19. Quality control measurements
2. Requirements management
plan
2. Activity list 20. Quality metrics
3. Schedule management plan 3. Assumption log 21. Quality report
4. Cost management plan 4. Basis of estimates 22. Requirements documentation
5. Quality management plan 5. Change log 23. Requirements traceability
matrix
6. Resource management plan 6. Cost estimates 24. Resource breakdown structure
7. Communications
management plan
7. Cost forecasts 25. Resource calendars
8. Risk management plan 8. Duration estimates 26. Resource requirements
9. Procurement management
plan
9. Issue log 27. Risk register
10. Stakeholder engagement
plan
10. Lessons learned register 28. Risk report
11. Change management plan 11. Milestone list 29. Schedule data
12. Configuration management
plan
12. Physical resource
assignments
30. Schedule forecasts
13. Scope baseline 13. Project calendars 31. Stakeholder register
14. Schedule baseline 14. Project communications 32. Team charter
15. Cost baseline 15. Project schedule 33. Test and evaluation documents
16. Performance measurement
baseline
16. Project schedule network
diagram
17. Project life cycle
description
17. Project scope statement
18. Development approach 18. Project team assignments
Business documents are documents that are generally originated outside of the
project, and are used as inputs to the project. Examples of business documents
include the business case and benefits management plan. The use of the business
documents will depend on the company culture and project initiation process.
The enterprise environmental factors that influence the project and the
organizational process assets available to the project will depend on the project
and project environment and are not listed in this standard.
1 Project Management Institute. 2017. A Guide to the Project Management
Body of Knowledge (PMBOK® Guide). Newtown Square, PA: Author.
2
INITIATING PROCESS GROUP
The Initiating Process Group consists of those processes performed to define a
new project or a new phase of an existing project by obtaining authorization to
start the project or phase. The purpose of the Initiating Process Group is to align
the stakeholders’ expectations and the project purpose, inform stakeholders of
the scope and objectives, and discuss how their participation in the project and
its associated phases can help to ensure their expectations are met. Within the
Initiating processes, the initial scope is defined and initial financial resources are
committed. Stakeholders who will interact and influence the overall outcome of
the project are identified. If not already assigned, the project manager is
appointed. This information is captured in the project charter and stakeholder
register. When the project charter is approved, the project is officially
authorized, and the project manager is authorized to apply organizational
resources to project activities.
The key benefits of this Process Group are that only projects that are aligned
with the organization's strategic objectives are authorized and that the business
case, benefits, and stakeholders are considered from the start of the project. In
some organizations, the project manager is involved in developing the business
case and defining the benefits. In those organizations, the project manager
generally helps write the project charter; in other organizations, the pre-project
work is done by the project sponsor, project management office (PMO),
portfolio steering committee, or other stakeholder group. This standard assumes
the project has been approved by the sponsor or other governing body and they
have reviewed the business documents prior to authorizing the project.
Business documents are documents that are generally originated outside of the
project, but are used as input to the project. Examples of business documents
include the business case, and benefits management plan. Figure 2-1 shows the
sponsor and the business documents in relation to the Initiating Processes.
As described in Section 1.5, projects are often divided into phases. When this
is done, information from processes in the Initiating Process Group is
reexamined to determine if the information is still valid. Revisiting the Initiating
processes at the start of each phase helps keep the project focused on the
business need that the project was undertaken to address. The project charter,
business documents, and success criteria are verified. The influence, drivers,
expectations, and objectives of the project stakeholders are reviewed.
Involving the sponsors, customers, and other stakeholders during initiation
creates a shared understanding of success criteria. It also increases the likelihood
of deliverable acceptance when the project is complete, and stakeholder
satisfaction throughout the project.
The Initiating Process Group includes the project management processes
identified in Sections 2.1 through 2.2.
2.1 DEVELOP PROJECT CHARTER
Develop Project Charter is the process of developing a document that formally
authorizes the existence of a project and provides the project manager with the
authority to apply organizational resources to project activities. The key benefits
of this process are that it provides a direct link between the project and the
strategic objectives of the organization, creates a formal record of the project,
and shows the organizational commitment to the project. This process is
performed once, or at predefined points in the project. The inputs and outputs of
this process are shown in Figure 2-3.
2.2 IDENTIFY STAKEHOLDERS
Identify Stakeholders is the process of identifying project stakeholders
regularly and analyzing and documenting relevant information regarding their
interests, involvement, interdependencies, influence, and potential impact on
project success. The key benefit of this process is that it enables the project team
to identify the appropriate focus for engagement of each stakeholder or group of
stakeholders. This process is performed periodically throughout the project as
needed. The inputs and outputs of this process are depicted in Figure 2-4.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
2.2.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Communications management plan, and
Stakeholder engagement plan.
2.2.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Change log,
Issue log, and
Requirements documentation.
2.2.3 PROJECT MANAGEMENT PLAN UPDATES
Examples of project management plan components that may be updated as a
result of this process include but are not limited to:
Requirements management plan,
Communications management plan,
Risk management plan, and
Stakeholder engagement plan.
2.2.4 PROJECT DOCUMENTS UPDATES
Examples of project documents that may be updated as a result of this process
include but are not limited to:
Assumption log,
Issue log, and
Risk register.
3
PLANNING PROCESS GROUP
The Planning Process Group consists of those processes that establish the total
scope of the effort, define and refine the objectives, and develop the course of
action required to attain those objectives. The processes in the Planning Process
Group develop the components of the project management plan and the project
documents used to carry out the project. The nature of a project may require the
use of repeated feedback loops for additional analysis. As more project
information or characteristics are gathered and understood, additional planning
will likely be required. Significant changes that occur throughout the project life
cycle may initiate a need to revisit one or more of the planning processes and,
possibly, one or both of the Initiating processes. This ongoing refinement of the
project management plan is called progressive elaboration, indicating that
planning and documentation are iterative or ongoing activities. The key benefit
of this Process Group is to define the course of action to successfully complete
the project or phase.
The project management team seeks input and encourages involvement from
relevant stakeholders while planning the project and developing the project
management plan and project documents. When the initial planning effort is
completed, the approved version of the project management plan is considered a
baseline. Throughout the project, the Monitoring and Controlling processes
compare the project performance to the baselines.
The Planning Process Group (Figure 3-1) includes the project management
processes identified in Sections 3.1 to 3.24.
3.1 DEVELOP PROJECT MANAGEMENT PLAN
Develop Project Management Plan is the process of defining, preparing, and
coordinating all plan components and consolidating them into an integrated
project management plan. The key benefit of this process is the production of a
comprehensive document that defines the basis of all project work and how the
work will be performed. This process is performed once or at predefined points
in the project. The inputs and outputs of this process are depicted in Figure 3-2.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.2 PLAN SCOPE MANAGEMENT
Plan Scope Management is the process of creating a scope management plan
that documents how the project and product scope will be defined, validated, and
controlled. The key benefit of this process is that it provides guidance and
direction on how scope will be managed throughout the project. This process is
performed once or at predefined points in the project. The inputs and outputs of
this process are depicted in Figure 3-3.
The needs of the project determine which components of the project
management plan are necessary.
3.2.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Quality management plan,
Project life cycle description, and
Development approach.
3.3 COLLECT REQUIREMENTS
Collect Requirements is the process of determining, documenting, and
managing stakeholder needs and requirements to meet objectives. The key
benefit of this process is that it provides the basis for defining the product scope
and project scope. This process is performed once or at predefined points in the
project. The inputs and outputs of this process are depicted in Figure 3-4.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.3.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan,
Requirements management plan, and
Stakeholder engagement plan.
3.3.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Lessons learned register, and
Stakeholder register.
3.4 DEFINE SCOPE
Define Scope is the process of developing a detailed description of the project
and product. The key benefit of this process is that it describes the product,
service, or result boundaries and acceptance criteria. This process is performed
once or at predefined points in the project. The inputs and outputs of this process
are depicted in Figure 3-5.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.4.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the scope management plan.
3.4.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Requirements documentation, and
Risk register.
3.4.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Requirements documentation,
Requirements traceability matrix, and
Stakeholder register.
3.5 CREATE WBS
Create Work Breakdown Structure (WBS) is the process of subdividing
project deliverables and project work into smaller, more manageable
components. The key benefit of this process is that it provides a framework of
what has to be delivered. This process is performed once or at predefined points
in the project. The inputs and outputs of this process are depicted in Figure 3-6.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.5.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the scope management plan.
3.5.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Project scope statement, and
Requirements documentation.
3.5.3 PROJECT DOCUMENTS UPDATES
Project document that may be updated as a result of this process include but is
not limited to:
Assumption log, and
Requirements documentation.
3.6 PLAN SCHEDULE MANAGEMENT
Plan Schedule Management is the process of establishing the policies,
procedures, and documentation for planning, developing, managing, executing,
and controlling the project schedule. The key benefit of this process is that it
provides guidance and direction on how the project schedule will be managed
throughout the project. This process is performed once or at predefined points in
the project. The inputs and outputs of this process are depicted in Figure 3-7.
The needs of the project determine which components of the project
management plan are necessary.
3.6.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan, and
Development approach.
3.7 DEFINE ACTIVITIES
Define Activities is the process of identifying and documenting the specific
actions to be performed to produce the project deliverables. The key benefit of
this process is that it decomposes work packages into schedule activities that
provide a basis for estimating, scheduling, executing, monitoring, and
controlling the project work. This process is performed throughout the project.
The inputs and outputs of this process are depicted in Figure 3-8.
The needs of the project determine which components of the project
management plan are necessary.
3.7.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan, and
Scope baseline.
3.7.2 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Schedule baseline, and
Cost baseline.
3.8 SEQUENCE ACTIVITIES
Sequence Activities is the process of identifying and documenting
relationships among the project activities. The key benefit of this process is that
it defines the logical sequence of work to obtain the greatest efficiency given all
project constraints. This process is performed throughout the project. The inputs
and outputs of this process are depicted in Figure 3-9.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.8.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan, and
Scope baseline.
3.8.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Activity attributes,
Activity list,
Assumption log, and
Milestone list.
3.8.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Activity attributes,
Activity list,
Assumption log, and
Milestone list.
3.9 ESTIMATE ACTIVITY DURATIONS
Estimate Activity Durations is the process of estimating the number of work
periods needed to complete individual activities with estimated resources. The
key benefit of this process is that it provides the amount of time each activity
will take to complete. This process is performed throughout the project. The
inputs and outputs of this process are depicted in Figure 3-10.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.9.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan, and
Scope baseline.
3.9.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Activity attributes,
Activity list,
Assumption log,
Lessons learned register,
Milestone list,
Project team assignments,
Resource breakdown structure,
Resource calendars,
Resource requirements, and
Risk register.
3.9.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Activity attributes,
Assumption log,
Lessons learned register.
3.10 DEVELOP SCHEDULE
Develop Schedule is the process of analyzing activity sequences, durations,
resource requirements, and schedule constraints to create a schedule model for
project execution and monitoring and controlling. The key benefit of this process
is that it generates a schedule model with planned dates for completing project
activities. This process is performed throughout the project. The inputs and
outputs of this process are depicted in Figure 3-11.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.10.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan, and
Scope baseline.
3.10.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Activity attributes,
Activity list,
Assumption log,
Basis of estimates,
Duration estimates,
Lessons learned register,
Milestone list,
Project schedule network diagram,
Project team assignments,
Resource calendars,
Resource requirements, and
Risk register.
3.10.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Schedule management plan, and
Cost baseline.
3.10.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Activity attributes,
Assumption log,
Duration estimates,
Lessons learned register,
Resource requirements, and
Risk register.
3.11 PLAN COST MANAGEMENT
Plan Cost Management is the process of defining how the project costs will be
estimated, budgeted, managed, monitored, and controlled. The key benefit of
this process is that it provides guidance and direction on how the project costs
will be managed throughout the project. This process is performed once, or at
predefined points in the project. The inputs and outputs of this process are
depicted in Figure 3-12.
The needs of the project determine which components of the project
management plan are necessary.
3.11.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan, and
Risk management plan.
3.12 ESTIMATE COSTS
Estimate Costs is the process of developing an approximation of the monetary
resources needed to complete project work. The key benefit of this process is
that it determines the monetary resources required for the project. This process is
performed periodically throughout the project as needed. The inputs and outputs
of this process are depicted in Figure 3-13.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.12.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Cost management plan,
Quality management plan, and
Scope baseline.
3.12.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project schedule,
Resource requirements, and
Risk register.
3.12.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Lessons learned register, and
Risk register.
3.13 DETERMINE BUDGET
Determine Budget is the process of aggregating the estimated costs of
individual activities or work packages to establish an authorized cost baseline.
The key benefit of this process is that it determines the cost baseline against
which project performance can be monitored and controlled. This process is
performed once or at predefined points in the project. The inputs and outputs of
this process are depicted in Figure 3-14.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.13.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Cost management plan,
Resource management plan, and
Scope baseline.
3.13.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Basis of estimates,
Cost estimates,
Project schedule, and
Risk register.
3.13.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Cost estimates,
Project schedule, and
Risk register.
3.14 PLAN QUALITY MANAGEMENT
Plan Quality Management is the process of identifying quality requirements
and/or standards for the project and its deliverables, and documenting how the
project will demonstrate compliance with quality requirements and/or standards.
The key benefit of this process is that it provides guidance and direction on how
quality will be managed and verified throughout the project. This process is
performed once or at predefined points in the project. The inputs and outputs of
this process are shown in Figure 3-15.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.14.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Requirements management plan,
Risk management plan,
Stakeholder engagement plan, and
Scope baseline.
3.14.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Requirements documentation,
Requirements traceability matrix,
Risk register, and
Stakeholder register.
3.14.3 PROJECT MANAGEMENT PLAN UPDATES
Examples of project management plan components that may be updated as a
result of this process include but are not limited to:
Risk management plan, and
Scope baseline.
3.14.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Requirements traceability matrix,
Risk register, and
Stakeholder register.
3.15 PLAN RESOURCE MANAGEMENT
Plan Resource Management is the process of defining how to estimate,
acquire, manage, and utilize physical and team resources. The key benefit of this
process is that it establishes the approach and level of management effort needed
for managing project resources based on the type and complexity of the project.
This process is performed once or at predefined points in the project. The inputs
and outputs of this process are shown in Figure 3-16.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.15.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Quality management plan, and
Scope baseline.
3.15.2 PROJECT DOCUMENTS
Examples of project documents that may be inputs for this process include but
are not limited to:
Project schedule,
Requirements documentation,
Risk register, and
Stakeholder register.
3.15.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log, and
Risk register.
3.16 ESTIMATE ACTIVITY RESOURCES
Estimate Activity Resources is the process of estimating team resources and
the type and quantities of materials, equipment, and supplies necessary to
perform project work. The key benefit of this process is that it identifies the type,
quantity, and characteristics of resources required to complete the project. This
process is performed periodically throughout the project as needed. The inputs
and outputs of this process are depicted in Figure 3-17.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.16.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan, and
Scope baseline.
3.16.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Activity attributes,
Activity list,
Assumption log,
Cost estimates,
Resource calendars, and
Risk register.
3.16.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Activity attributes,
Assumption log,
Lessons learned register.
3.17 PLAN COMMUNICATIONS MANAGEMENT
Plan Communications Management is the process of developing an
appropriate approach and plan for project communication activities based on the
information needs of each stakeholder or group, available organizational assets,
and the needs of the project. The key benefit of this process is a documented
approach to effectively and efficiently engage stakeholders by presenting
relevant information in a timely manner. This process is performed periodically
throughout the project as needed. The inputs and outputs of this process are
depicted in Figure 3-18.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.17.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan, and
Stakeholder engagement plan.
3.17.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Requirements documentation, and
Stakeholder register.
3.17.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to the stakeholder engagement plan.
3.17.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Project schedule, and
Stakeholder register.
3.18 PLAN RISK MANAGEMENT
Plan Risk Management is the process of defining how to conduct risk
management activities for a project. The key benefit of this process is that it
ensures that the degree, type, and visibility of risk management are proportionate
to both the risks and the importance of the project to the organization and other
stakeholders. This process is performed once or at predefined points in the
project. The inputs and output of this process are depicted in Figure 3-19.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.18.1 PROJECT MANAGEMENT PLAN COMPONENTS
In planning Project Risk Management, all available components of the project
management plan should be taken into consideration in order to ensure risk
management is consistent with the needs of the project.
3.18.2 PROJECT DOCUMENTS EXAMPLES
An example of a project document that may be an input for this process
includes but is not limited to the stakeholder register.
3.19 IDENTIFY RISKS
Identify Risks is the process of identifying individual project risks as well as
sources of overall project risk, and documenting their characteristics. The key
benefit of this process is the documentation of the existing individual project
risks and the sources of overall project risk. It also brings together information
so the project team can to respond appropriately to the identified risks. This
process is performed throughout the project. The inputs and outputs of this
process are depicted in Figure 3-20.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.19.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Requirements management plan,
Schedule management plan,
Cost management plan,
Quality management plan,
Resource management plan,
Risk management plan,
Scope baseline,
Schedule baseline, and
Cost baseline.
3.19.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Cost estimates,
Duration estimates,
Issue log,
Lessons learned register,
Requirements documentation,
Resource requirements, and
Stakeholder register.
3.19.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Issue log, and
Lessons learned register.
3.20 PERFORM QUALITATIVE RISK ANALYSIS
Perform Qualitative Risk Analysis is the process of prioritizing individual
project risks for further analysis or action by assessing their probability of
occurrence and impact as well as other characteristics. The key benefit of this
process is that it focuses efforts on high-priority risks. This process is performed
throughout the project. The inputs and outputs of this process are depicted in
Figure 3-21.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.20.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the risk management plan.
3.20.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Risk register, and
Stakeholder register.
3.20.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Issue log,
Risk register, and
Risk report.
3.21 PERFORM QUANTITATIVE RISK ANALYSIS
Perform Quantitative Risk Analysis is the process of numerically analyzing
the combined effect of identified individual project risks and other sources of
uncertainty on overall project objectives. The key benefit of this process is that it
quantifies overall project risk exposure and can also provide additional
quantitative risk information to support risk response planning. This process is
performed throughout the project. The inputs and outputs of this process are
depicted in Figure 3-22.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.21.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Risk management plan,
Scope baseline,
Schedule baseline, and
Cost baseline.
3.21.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Basis of estimates,
Cost estimates,
Cost forecasts,
Duration estimates,
Milestone list,
Resource requirements,
Risk register,
Risk report, and
Schedule forecasts.
3.21.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to the risk report.
3.22 PLAN RISK RESPONSES
Plan Risk Responses is the process of developing options, selecting strategies,
and agreeing on actions to address overall project risk exposure as well as to
treat individual project risks. The key benefit of this process is that it identifies
appropriate ways to address overall project risk and individual project risks. This
process also allocates resources and inserts activities into project documents and
the project management plan as needed. This process is performed throughout
the project. The inputs and outputs of this process are depicted in Figure 3-23.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.22.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Risk management plan, and
Cost baseline.
3.22.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project schedule,
Project team assignments,
Resource calendars,
Risk register,
Risk report, and
Stakeholder register.
3.22.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Schedule management plan,
Cost management plan,
Quality management plan,
Resource management plan,
Procurement management plan,
Scope baseline,
Schedule baseline, and
Cost baseline.
3.22.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Cost forecasts,
Lessons learned register,
Project schedule,
Project team assignments,
Risk register, and
Risk report.
3.23 PLAN PROCUREMENT MANAGEMENT
Plan Procurement Management is the process of documenting project
procurement decisions, specifying the approach, and identifying potential sellers.
The key benefit of this process is that it determines whether to acquire goods and
services from outside the project and, if so, what to acquire as well as how and
when to acquire it. Goods and services may be procured from other parts of the
performing organization or from external sources. This process is performed
once or at predefined points in the project. The inputs and outputs of this process
are depicted in Figure 3-24.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.23.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan,
Quality management plan,
Resource management plan, and
Scope baseline.
3.23.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Milestone list,
Project team assignments,
Requirements documentation,
Requirements traceability matrix,
Resource requirements,
Risk register, and
Stakeholder register.
3.23.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Milestone list,
Requirements documentation,
Requirements traceability matrix,
Risk register, and
Stakeholder register.
3.24 PLAN STAKEHOLDER ENGAGEMENT
Plan Stakeholder Engagement is the process of developing approaches to
involve project stakeholders based on their needs, expectations, interests, and
potential impact on the project. The key benefit is that it provides an actionable
plan to interact with stakeholders effectively. This process is performed
periodically throughout the project as needed. The inputs and outputs of this
process are depicted in Figure 3-25.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
3.24.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Communications management plan, and
Risk management plan.
3.24.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Change log,
Issue log,
Project schedule,
Risk register, and
Stakeholder register.
4
EXECUTING PROCESS GROUP
The Executing Process Group consists of those processes performed to
complete the work defined in the project management plan to satisfy the project
requirements. This Process Group involves coordinating resources, managing
stakeholder engagement, and integrating and performing the activities of the
project in accordance with the project management plan. The key benefit of this
Process Group is that the work needed to meet the project requirements and
objectives is performed according to plan. A large portion of the project budget,
resources, and time is expended in performing the Executing Process Group
processes. The processes in the Executing Process Group may generate change
requests. If approved, the change requests may trigger one or more planning
processes that result in a modified management plan, project documents, and
possibly new baselines. The Executing Process Group (Figure 4-1) includes the
project management processes identified in Sections 4.1 through 4.10.
4.1 DIRECT AND MANAGE PROJECT WORK
Direct and Manage Project Work is the process of leading and performing the
work defined in the project management plan and implementing approved
changes to achieve the project's objectives. The key benefit of this process is that
it provides overall management of the project work and deliverables, thus
improving the probability of project success. This process is performed
throughout the project. The inputs and outputs of this process are depicted in
Figure 4-2.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.1.1 PROJECT MANAGEMENT PLAN COMPONENTS
Any component of the project management plan may be an input for this
process.
4.1.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Change log,
Lessons learned register,
Milestone list,
Project communications,
Project schedule,
Requirements traceability matrix,
Risk register, and
Risk report.
4.1.3 PROJECT MANAGEMENT PLAN UPDATES
Any component of the project management plan may be updated as a result of
this process.
4.1.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Activity list,
Assumption log,
Lessons learned register,
Requirements documentation,
Risk register, and
Stakeholder register.
4.2 MANAGE PROJECT KNOWLEDGE
Manage Project Knowledge is the process of using existing knowledge and
creating new knowledge to achieve the project's objectives and contribute to
organizational learning. The key benefits of this process are that prior
organizational knowledge is leveraged to produce or improve the project
outcomes and that knowledge created by the project is available to support
organizational operations and future projects or phases. This process is
performed throughout the project. The inputs and outputs of this process are
depicted in Figure 4-3.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.2.1 PROJECT MANAGEMENT PLAN COMPONENTS
All components of the project management plan may be inputs for this
process.
4.2.2 PROJECT DOCUMENTS
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project team assignments,
Resource breakdown structure,
Source selection criteria, and
Stakeholder register.
4.2.3 PROJECT MANAGEMENT PLAN UPDATES
Any component of the project management plan may be updated as a result of
this process.
4.3 MANAGE QUALITY
Manage Quality is the process of translating the quality management plan into
executable quality activities that incorporate the organization's quality policies
into the project. The key benefit of this process is that it increases the probability
of meeting the quality objectives, as well as identifying ineffective processes and
causes of poor quality. This process is performed throughout the project. The
inputs and outputs of this process are shown in Figure 4-4.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.3.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the quality management plan.
4.3.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Quality control measurements,
Quality metrics, and
Risk report.
4.3.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Quality management plan,
Scope baseline,
Schedule baseline,
Cost baseline.
4.3.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register, and
Risk register.
4.4 ACQUIRE RESOURCES
Acquire Resources is the process of obtaining team members, facilities,
equipment, materials, supplies, and other resources necessary to complete
project work. The key benefit of this process is that it outlines and guides the
selection of resources and assigns them to their respective activities. This
process is performed periodically throughout the project as needed. The inputs
and outputs of this process are shown in Figure 4-5.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.4.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Procurement management plan, and
Cost baseline.
4.4.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Project schedule
Resource calendars,
Resource requirements, and
Stakeholder register.
4.4.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Resource management plan, and
Cost baseline.
4.4.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Project schedule,
Resource breakdown structure,
Resource calendars,
Resource requirements,
Risk register, and
Stakeholder register.
4.5 DEVELOP TEAM
Develop Team is the process of improving competencies, team member
interaction, and overall team environment to enhance project performance. The
key benefit of this process is that it results in improved teamwork, enhanced
interpersonal skills and competencies, motivated employees, reduced attrition,
and improved overall project performance. This process is performed throughout
the project. The inputs and outputs of this process are shown in Figure 4-6.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.5.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the resource management plan.
4.5.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project schedule,
Project team assignments,
Resource calendars, and
Team charter.
4.5.3 PROJECT MANAGEMENT PLAN UPDATES
A component of the project management plan that may be updated as a result
of this process includes but is not limited to the resource management plan.
4.5.4 PROJECT DOCUMENTS UPDATES
A project document that may be updated as a result of this process includes
but is not limited to:
Lessons learned register,
Project schedule,
Project team assignments,
Resource calendars, and
Team charter.
4.6 MANAGE TEAM
Manage Team is the process of tracking team member performance, providing
feedback, resolving issues, and managing team changes to optimize project
performance. The key benefit of this process is that it influences team behavior,
manages conflict, and resolves issues. This process is performed throughout the
project. The inputs and outputs of this process are shown in Figure 4-7.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.6.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the resource management plan.
4.6.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Issue log,
Lessons learned register,
Project team assignments, and
Team charter.
4.6.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Resource management plan,
Schedule baseline, and
Cost baseline.
4.6.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register, and
Project team assignments.
4.7 MANAGE COMMUNICATIONS
Manage Communications is the process of ensuring timely and appropriate
collection, creation, distribution, storage, retrieval, management, monitoring, and
the ultimate disposition of project information. The key benefit of this process is
that it enables an efficient and effective information flow between the project
team and the stakeholders. This process is performed throughout the project. The
inputs and outputs of this process are depicted in Figure 4-8.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.7.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Communications management plan, and
Stakeholder engagement plan.
4.7.2 PROJECT DOCUMENTS EXAMPLE
Examples of project documents that may be inputs for this process include but
are not limited to:
Change log,
Issue log,
Lessons learned register,
Quality report,
Risk report, and
Stakeholder register.
4.7.3 PROJECT MANAGEMENT PLAN UPDATES
Examples of the project management plan components that may be updated as
a result of this process include but are not limited to:
Communications management plan, and
Stakeholder engagement plan.
4.7.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register,
Project schedule,
Risk register, and
Stakeholder register.
4.8 IMPLEMENT RISK RESPONSES
Implement Risk Responses is the process of implementing agreed-upon risk
response plans. The key benefit of this process is that it ensures that agreed-upon
risk responses are executed as planned in order to address overall project risk
exposure, as well as to minimize individual project threats and maximize
individual project opportunities. This process is performed throughout the
project. The inputs and outputs of this process are depicted in Figure 4-9.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.8.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the risk management plan.
4.8.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Risk register, and
Risk report.
4.8.3 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register,
Project team assignments,
Risk register, and
Risk report.
4.9 CONDUCT PROCUREMENTS
Conduct Procurements is the process of obtaining seller responses, selecting a
seller, and awarding a contract. The key benefit of this process is that it selects a
qualified seller and implements the legal agreement for delivery. This process is
performed periodically throughout the project as needed. The inputs and outputs
of this process are depicted in Figure 4-10.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.9.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan,
Requirements management plan,
Communications management plan,
Risk management plan,
Procurement management plan,
Configuration management plan, and
Cost baseline.
4.9.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project schedule,
Requirements documentation,
Risk register, and
Stakeholder register.
4.9.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Requirements management plan,
Quality management plan,
Communications management plan,
Risk management plan,
Procurement management plan,
Scope baseline,
Schedule baseline, and
Cost baseline.
4.9.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Requirements documentation,
Requirements traceability matrix,
Resource calendars,
Risk register, and
Stakeholder register.
4.10 MANAGE STAKEHOLDER ENGAGEMENT
Manage Stakeholder Engagement is the process of communicating and
working with stakeholders to meet their needs and expectations, address issues,
and foster appropriate stakeholder involvement. The key benefit of this process
is that it allows the project manager to increase support and minimize resistance
from stakeholders. This process is performed throughout the project. The inputs
and outputs of this process are depicted in Figure 4-11.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
4.10.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Communications management plan,
Risk management plan,
Stakeholder engagement plan, and
Change management plan.
4.10.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Change log,
Issue log,
Lessons learned register, and
Stakeholder register.
4.10.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Communications management plan, and
Stakeholder engagement plan.
4.10.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Change log,
Issue log,
Lessons learned register, and
Stakeholder register.
5
MONITORING AND CONTROLLING PROCESS
GROUP
The Monitoring and Controlling Process Group consists of those processes
required to track, review, and regulate the progress and performance of the
project; identify any areas in which changes to the plan are required; and initiate
the corresponding changes. Monitoring is collecting project performance data,
producing performance measures, and reporting and disseminating performance
information. Controlling is comparing actual performance with planned
performance, analyzing variances, assessing trends to effect process
improvements, evaluating possible alternatives, and recommending appropriate
corrective action as needed. The key benefit of this Process Group is that project
performance is measured and analyzed at regular intervals, appropriate events, or
when exception conditions occur in order to identify and correct variances from
the project management plan. The Monitoring and Controlling Process Group
also involves:
Evaluating change requests and deciding on the appropriate response;
Recommending corrective or preventive action in anticipation of
possible problems;
Monitoring the ongoing project activities against the project
management plan and project baselines; and
Influencing the factors that could circumvent the change control
process so only approved changes are implemented.
Continuous monitoring provides the project team and other stakeholders with
insight into the status of the project and identifies any areas that require
additional attention. The Monitoring and Controlling Process Group monitors
and controls the work being done within each Knowledge Area, each Process
Group, each life cycle phase, and the project as a whole. The Monitoring and
Controlling Process Group (Figure 5-1) includes the project management
processes identified in Sections 5.1 through 5.12.
5.1 MONITOR AND CONTROL PROJECT WORK
Monitor and Control Project Work is the process of tracking, reviewing, and
reporting the overall progress to meet the performance objectives defined in the
project management plan. The key benefit of this process is that it allows
stakeholders to understand the current state of the project, to recognize the
actions taken to address any performance issues, and to have visibility into the
future project status with cost and schedule forecasts. This process is performed
throughout the project. The inputs and outputs for this process are depicted in
Figure 5-2.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.1.1 PROJECT MANAGEMENT PLAN COMPONENTS
Any component of the project management plan may be an input for this
process.
5.1.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Basis of estimates,
Cost forecasts,
Issue log,
Lessons learned register,
Milestone list,
Quality reports,
Risk register,
Risk report, and
Schedule forecasts.
5.1.3 PROJECT MANAGEMENT PLAN UPDATES
Any component of the project management plan may be updated as a result of
this process.
5.1.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Cost forecasts,
Issue log,
Lessons learned register,
Risk register, and
Schedule forecasts.
5.2 PERFORM INTEGRATED CHANGE CONTROL
Perform Integrated Change Control is the process of reviewing all change
requests; approving changes and managing changes to deliverables,
organizational process assets, project documents, and the project management
plan; and communicating the decisions. This process reviews all requests for
changes to project documents, deliverables, or the project management plan, and
determines the resolution of the change requests. The key benefit of this process
is that it allows for documented changes within the project to be considered in an
integrated manner while addressing overall project risk, which often arises from
changes made without consideration of the overall project objectives or plans.
This process is performed throughout the project. The inputs and outputs of this
process are depicted in Figure 5-3.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.2.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Change management plan,
Configuration management plan,
Scope baseline,
Schedule baseline, and
Cost baseline.
5.2.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Basis of estimates,
Requirements traceability matrix, and
Risk report.
5.2.3 PROJECT MANAGEMENT PLAN UPDATES
Any component of the project management plan may be updated as a result of
this process.
5.2.4 PROJECT DOCUMENTS UPDATES
Any formally controlled project document may be changed as a result of this
process. A project document that is normally updated as a result of this process
is the change log. The change log is used to document changes that occur during
a project.
5.3 VALIDATE SCOPE
Validate Scope is the process of formalizing acceptance of the completed
project deliverables. The key benefit of this process is that it brings objectivity to
the acceptance process and increases the probability of final product, service, or
result acceptance by validating each deliverable. This process is performed
periodically throughout the project as needed. The inputs and outputs of this
process are depicted in Figure 5-4.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.3.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan,
Requirements management plan, and
Scope baseline.
5.3.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Quality reports,
Requirements documentation, and
Requirements traceability matrix.
5.3.3 PROJECT DOCUMENTS UPDATES
Examples of project documents that may be updated as a result of this process
include but are not limited to:
Lessons learned register,
Requirements documentation, and
Requirements traceability matrix.
5.4 CONTROL SCOPE
Control Scope is the process of monitoring the status of the project and
product scope and managing changes to the scope baseline. The key benefit of
this process is that the scope baseline is maintained throughout the project. This
process is performed throughout the project. The inputs and outputs of this
process are depicted in Figure 5-5.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.4.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Scope management plan,
Requirements management plan,
Change management plan,
Configuration management plan,
Scope baseline, and
Performance measurement baseline.
5.4.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Requirements documentation, and
Requirements traceability matrix.
5.4.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Scope management plan,
Scope baseline,
Schedule baseline,
Cost baseline and
Performance measurement baseline.
5.4.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Requirements documentation, and
Requirements traceability matrix.
5.5 CONTROL SCHEDULE
Control Schedule is the process of monitoring the status of the project to
update the project schedule and manage changes to the schedule baseline. The
key benefit of this process is that the schedule baseline is maintained throughout
the project. This process is performed throughout the project. The inputs and
outputs of this process are depicted in Figure 5-6.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.5.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Schedule management plan,
Schedule baseline,
Scope baseline, and
Performance measurement baseline.
5.5.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Project calendars,
Project schedule,
Resource calendars, and
Schedule data.
5.5.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Schedule management plan,
Schedule baseline, and
Cost baseline and
Performance measurement baseline.
5.5.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Basis of estimates,
Lessons learned register,
Project schedule,
Resource calendars,
Risk register, and
Schedule data.
5.6 CONTROL COSTS
Control Costs is the process of monitoring the status of the project to update
the project costs and managing changes to the cost baseline. The key benefit of
this process is that the cost baseline is maintained throughout the project. This
process is performed throughout the project. The inputs and outputs of this
process are depicted in Figure 5-7.
The needs of the project determine which components of the project
management plan are necessary.
5.6.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Cost management plan,
Cost baseline, and
Performance measurement baseline.
5.6.2 PROJECT DOCUMENTS EXAMPLES
An example of a project document that may an input for this process includes
but is not limited to the lessons learned register.
5.6.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Cost management plan,
Cost baseline, and
Performance measurement baseline.
5.6.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Basis of estimates,
Cost estimates,
Lessons learned register, and
Risk register.
5.7 CONTROL QUALITY
Control Quality is the process of monitoring and recording results of
executing the quality management activities to assess performance and ensure
the project outputs are complete, correct, and meet customer expectations. The
key benefit of this process is verifying that project deliverables and work meet
the requirements specified by key stakeholders for final acceptance. This process
is performed throughout the project. The inputs and outputs of this process are
shown in Figure 5-8.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.7.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the quality management plan.
5.7.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Lessons learned register,
Quality metrics, and
Test and evaluation documents.
5.7.3 PROJECT MANAGEMENT PLAN UPDATES
A component of the project management plan that may be updated as a result
of this process includes but is not limited to the quality management plan.
5.7.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register,
Risk register, and
Test and evaluation documents.
5.8 CONTROL RESOURCES
Control Resources is the process of ensuring that the physical resources
assigned and allocated to the project are available as planned, as well as
monitoring the planned versus actual utilization of resources and taking
corrective action as necessary. The key benefit of this process is ensuring that
the assigned resources are available to the project at the right time and in the
right place and are released when no longer needed. This process is performed
throughout the project. The inputs and outputs of this process are shown in
Figure 5-9.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.8.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the resource management plan.
5.8.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Issue log,
Lessons learned register,
Physical resource assignments,
Project schedule
Resource breakdown structure,
Resource requirements, and
Risk register.
5.8.3 PROJECT MANAGEMENT PLAN UPDATES
A component of the project management plan that may be updated as a result
of this process includes but is not limited to:
Resource management plan,
Schedule baseline, and
Cost baseline.
5.8.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Issue log,
Lessons learned register,
Physical resource assignments,
Resource breakdown structure, and
Risk register.
5.9 MONITOR COMMUNICATIONS
Monitor Communications is the process of ensuring the information needs of
the project and its stakeholders are met. The key benefit of this process is the
optimal information flow as defined in the communications management plan
and stakeholder engagement plan. This process is performed throughout the
project. The inputs and outputs of this process are depicted in Figure 5-10.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.9.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Communications management plan, and
Stakeholder engagement plan.
5.9.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Issue log,
Lessons learned register, and
Project communications.
5.9.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Communications management plan, and
Stakeholder engagement plan.
5.9.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register, and
Stakeholder register.
5.10 MONITOR RISKS
Monitor Risks is the process of monitoring the implementation of agreed-upon
risk response plans, tracking identified risks, identifying and analyzing new
risks, and evaluating risk process effectiveness throughout the project. The key
benefit of this process is that it enables project decisions to be based on current
information about overall project risk exposure and individual project risks. This
process is performed throughout the project. The inputs and outputs of this
process are depicted in Figure 5-11.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.10.1 PROJECT MANAGEMENT PLAN COMPONENTS
An example of a project management plan component that may be an input
for this process includes but is not limited to the risk management plan.
5.10.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Issue log,
Lessons learned register,
Risk register, and
Risk report.
5.10.3 PROJECT MANAGEMENT PLAN UPDATES
Any component of the project management plan may be updated as a result of
this process.
5.10.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Assumption log,
Issue log,
Lessons learned register,
Risk register, and
Risk report.
5.11 CONTROL PROCUREMENTS
Control Procurements is the process of managing procurement relationships,
monitoring contract performance and making changes and corrections as
appropriate, and closing out contracts. The key benefit of this process is that it
ensures that both the seller's and buyer's performance meets the project's
requirements according to the terms of the legal agreements. This process is
performed throughout the project, when procurements are active. The inputs and
outputs of this process are depicted in Figure 5-12.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.11.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Requirements management plan,
Risk management plan,
Procurement management plan,
Change management plan, and
Schedule baseline.
5.11.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Lessons learned register,
Milestone list,
Quality reports,
Requirements documentation,
Requirements traceability matrix,
Risk register, and
Stakeholder register.
5.11.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Risk management plan,
Procurement management plan,
Schedule baseline, and
Cost baseline.
5.11.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Lessons learned register,
Resource requirements,
Requirements traceability matrix,
Risk register, and
Stakeholder register.
5.12 MONITOR STAKEHOLDER ENGAGEMENT
Monitor Stakeholder Engagement is the process of monitoring project
stakeholder relationships, and tailoring strategies for engaging stakeholders
through modification of engagement strategies and plans. The key benefit of this
process is that it maintains or increases the efficiency and effectiveness of
stakeholder engagement activities as the project evolves and its environment
changes. This process is performed throughout the project. The inputs and
outputs of this process are depicted in Figure 5-13.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
5.12.1 PROJECT MANAGEMENT PLAN COMPONENTS
Examples of project management plan components that may be inputs for this
process include but are not limited to:
Resource management plan,
Communications management plan, and
Stakeholder engagement plan.
5.12.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Issue log,
Lessons learned register,
Project communications,
Risk register, and
Stakeholder register.
5.12.3 PROJECT MANAGEMENT PLAN UPDATES
Components of the project management plan that may be updated as a result
of this process include but are not limited to:
Resource management plan,
Communications management plan, and
Stakeholder engagement plan.
5.12.4 PROJECT DOCUMENTS UPDATES
Project documents that may be updated as a result of this process include but
are not limited to:
Issue log,
Lessons learned register,
Risk register, and
Stakeholder register.
6
CLOSING PROCESS GROUP
The Closing Process Group consists of the process(es) performed to formally
complete or close a project, phase, or contract. This Process Group verifies that
the defined processes are completed within all of the Process Groups to close the
project or phase, as appropriate, and formally establishes that the project or
project phase is complete. The key benefit of this Process Group is that phases,
projects, and contracts are closed out appropriately. While there is only one
process in this Process Group, organizations may have their own processes
associated with project, phase, or contract closure. Therefore, the term Process
Group is maintained.
This Process Group may also address the early closure of the project, for
example, aborted projects or cancelled projects.
The Closing Process Group (Figure 6-1) includes the project management
process identified in Section 6.1.
6.1 CLOSE PROJECT OR PHASE
Close Project or Phase is the process of finalizing all activities for the project,
phase, or contract. The key benefits of this process are the project or phase
information is archived, the planned work is completed, and organizational
resources are released to pursue new endeavors. This process is performed once
or at predefined points in the project. The inputs and outputs of this process are
depicted in Figure 6-2.
The needs of the project determine which components of the project
management plan and which project documents are necessary.
6.1.1 PROJECT MANAGEMENT PLAN COMPONENTS
All components of the project management plan may be inputs to this process.
6.1.2 PROJECT DOCUMENTS EXAMPLES
Examples of project documents that may be inputs for this process include but
are not limited to:
Assumption log,
Basis of estimates,
Change log,
Issue log,
Lessons learned register,
Milestone list,
Project communications,
Quality control measurements,
Quality reports,
Requirements documentation,
Risk register, and
Risk report.
6.1.3 PROJECT DOCUMENTS UPDATES
Any project documents that may be updated as a result of this process include
but are not limited to the lessons learned register.
Part 3
Appendices, Glossary, and Index
The information contained in this part is not an American National Standard (ANS) and has not been
processed in accordance with ANSI's requirements for an ANS. As such, the information in this part may
contain material that has not been subjected to public review or a consensus process. In addition, it does not
contain requirements necessary for conformance to an ANS standard.
APPENDIX X1
SIXTH EDITION CHANGES
The purpose of this appendix is to provide an overview of the changes made
to A Guide to the Project Management Body of Knowledge (PMBOK® Guide)
—Fifth Edition to create the PMBOK® Guide—Sixth Edition.
X1.1 SCOPE OF UPDATE
The approved scope for the PMBOK® Guide—Sixth Edition includes:
Review the following and determine whether the material will be
included or excluded in the new editions, and track the disposition:
All material relevant to Sections 1 through 13, Annex A1, and the
Glossary that was deferred during the development of A Guide to the
Project Management Body of Knowledge (PMBOK® Guide)—Fifth
Edition
All comments and feedback relevant to Sections 1 through 13, Annex
A1, and the Glossary of A Guide to the Project Management Body
of Knowledge (PMBOK® Guide)—Fifth Edition that have been
received by PMI since the initial development and publication.
Review, interpret, and ensure appropriate alignment with ISO 21500 in
the development of the standard.
Ensure harmonization with any other relevant PMI foundational
standards.
Consider the project manager role delineation study results and other
PMI research studies for incorporation as appropriate.
Review, conduct, and analyze research for significant additions,
deletions, and changes to the Sixth Edition and possibly for strategic
input to future editions.
With that directive in mind, the update team focused on bringing greater
consistency and clarity by refining and standardizing the processes, inputs, tools
and techniques, and outputs.
X1.2 RULES FOR HARMONIZATION BETWEEN GLOSSARY
TERMS AND THE PMI LEXICON OF PROJECT
MANAGEMENT TERMS
To ensure that terms used in the PMBOK® Guide align with the PMI
Lexicon of Project Management Terms 1 and harmonize with other relevant
PMI standards, the Sixth Edition followed these business rules:
For terms found in both the PMBOK® Guide and the PMI Lexicon,
the definition from the PMI Lexicon is used.
Where terms used in the PMBOK® Guide are not found in the PMI
Lexicon but are found in other relevant PMI standards, the definitions
of the terms should be identical. If the definitions do not align with the
respective standards, the term is elevated to the PMI Lexicon team for
assistance in creating an acceptable common definition.
X1.3 RULES FOR HANDLING INPUTS AND OUTPUTS
The following business rules were used to provide consistency in the order
and information within the inputs and outputs for each project management
process:
Fundamental Rules:
Inputs are any documents that are key to the process.
Outputs should become an input to another project management
process unless the output is a terminal output or embedded within
another input such as project documents.
Inputs should come from an output from another project management
process unless the input comes from outside the project.
Project Documents Rules:
When specific project documents are identified the first time, they are
listed as a specific output. Subsequently, they are listed as “project
documents updates” in the output list, and described in the section
narrative.
When any project document is an input, the term “project
documents” is listed and the specific project documents are described
in the section narrative.
Project Management Plan Rules:
For those planning processes that create a subsidiary plan, the project
charter is the first input and the project management plan is the
second input.
The process that creates a component of the project management plan
lists the component specifically. Subsequently, components are listed
as “project management plan updates” in the output list, and
described in the section narrative.
When the project management plan serves as a process input, specific
components of the project management plan that may be considered
are described in the section narrative.
Sequencing Rules:
If the project charter is an input, it is the first input.
When the project management plan is an input or output, the
subsidiary management plans are listed in the order of the sections in
the PMBOK® Guide where they are produced as an output, followed
by baselines and then any other plans.
Project documents are listed in alphabetical order.
Enterprise environmental factors and organizational process assets
are listed last in that order.
When updates are an output they are listed in the following sequence:
Project management plan updates,
Project documents updates, and
Organizational process assets updates.
X1.4 RULES FOR HANDLING TOOLS AND TECHNIQUES
The Sixth Edition endeavored to reduce the number of tools and techniques by
focusing on those that are currently used on most projects most of the time.
Based on academic and market research a number of tools and techniques were
eliminated. In order to reduce repetition a tool or technique is described the first
time it is listed and subsequent processes using that tool or technique refer back
to the earlier description.
The Sixth Edition grouped some of the commonly used tools and techniques
by their intent. Not all tools and techniques fall within a group, but for those
tools or techniques that are part of a group, the group is listed and then examples
of tools and techniques in that group are described in the narrative. The tools and
techniques groups are:
Data gathering,
Data analysis,
Data representation,
Decision-making,
Communication skills, and
Interpersonal and team skills.
Appendix X6 identifies all the tools and techniques in the PMBOK® Guide
by group, where appropriate, and lists the processes where they are used.
X1.5 PROJECT MANAGEMENT PLAN
Not every component of the project management plan is created in a separate
process. Such components are considered to be created in the Develop Project
Management Plan process. They include the change management plan,
configuration management plan, performance measurement baseline, project life
cycle, development approach, and management reviews.
X1.6 SECTION 1—INTRODUCTION
The Introduction section was significantly rewritten. Introductory information
about projects, programs, and portfolios that aligns with other PMI foundational
standards remains. However, there is new information on project and
development life cycles, project phases, and phase gates. This information
provides a high-level overview on selecting development approaches from
predictive, iterative, incremental and adaptive, based on the nature of the project.
New information on business documents includes the business case and the
benefits management plan.
X1.7 SECTION 2—THE ENVIRONMENT IN WHICH PROJECTS
OPERATE
The content of Section 2 was significantly rewritten. Information on
organizational process assets and enterprise environmental factors remains.
However, there is new content on governance, management elements, and
organizational structure types.
X1.8 Section 3—THE ROLE OF THE PROJECT MANAGER
This is a new section that outlines the project manager's role on the team. It
includes information on the project manager's sphere of influence and
competencies. PMI's Talent Triangle® is discussed with its emphasis on
strategic and business management skills, technical project management skills,
and leadership skills. Leadership styles and personality are also discussed as part
of this section. The final part of this section focuses on the project manager as an
integrator.
X1.9 AGILE
Since the Fifth Edition of the PMBOK® Guide there has been more adoption
of agile and adaptive methodologies in the management of projects. The Sixth
Edition has included a subsection called Considerations for Adaptive
Environments at the beginning of Sections 4 through 13. Some agile-specific
tools and techniques have been introduced into the PMBOK® Guide, such as
sprint and iteration planning. Appendix X3 describes the use of agile, adaptive,
iterative, and hybrid approaches from the perspective of the Project Management
Process Groups.
X1.10 KNOWLEDGE AREA FRONT MATERIAL
Each of the Knowledge Area sections includes standardized material prior to
introducing the first process. The material is presented in the following
subsections:
Key Concepts. Collects key concepts associated with the specific
knowledge area. This information was presented in earlier editions; in
this edition it is consolidated and presented for consistency between
knowledge areas. These key concepts are compiled in Appendix X4.
Trends and Emerging Practices. The profession of project management
continues to evolve. However, the purpose of the PMBOK® Guide is
not to lead the industry; it is to describe what is considered good
practice on most projects most of the time. This subsection identifies
some of the trends or emerging practices that are occurring, but that
may not be practiced on most projects.
Tailoring Considerations. The Sixth Edition emphasizes the
importance of tailoring all aspects of the project to meet the needs of
the organization, environment, stakeholders and other variables. This
subsection identifies areas the project manager can consider when
tailoring their project. These tailoring considerations are compiled in
Appendix X5.
Considerations for Agile/Adaptive Environments. This subsection
identifies some of the areas where adaptive approaches may differ
from predictive approaches in the particular Knowledge Area.
X1.11 KNOWLEDGE AREA AND PROCESS CHANGES
Two Knowledge Areas names were changed to more closely reflect the work
that is done.
Project Time Management was changed to Project Schedule
Management to reflect that the project schedule is defined and
managed during the project, whereas time is not managed.
Both team resources and physical resources are addressed in the Sixth
Edition. Thus, the Knowledge Area Project Human Resource
Management was changed to Project Resource Management.
One process was removed and three new processes were added, to reflect
changes in the way projects are managed in practice. One process was moved
between Knowledge Areas. These changes are summarized below, and discussed
in the relevant Knowledge Area section:
Manage Project Knowledge (Section 4.4)—Added.
Estimate Activity Resources (Section 6.4)—Moved to Project
Resource Management.
Control Resources (Section 9.6)—Added.
Implement Risk Responses (Section 11.6)—Added.
Close Procurements (Section 12.4)—Eliminated.
Several process names were changed to improve consistency across the
processes and to improve clarity. Research indicates that project managers tend
to monitor, facilitate, and manage rather than control, particularly in processes
that involve interactions with people. Therefore, process names for Control
Communications, Control Risks, and Control Stakeholder Engagement were
changed to Monitor Communications, Monitor Risks, and Monitor Stakeholder
Engagement. The list below summarizes all the process name changes:
Perform Quality Assurance (Section 8.2)—Changed to Manage
Quality.
Plan Human Resource Management (Section 9.1)—Changed to Plan
Resource Management.
Acquire Project Team (Section 9.2)—Changed to Acquire Resources.
Develop Project Team (Section 9.3)—Changed to Develop Team.
Manage Project Team (Section 9.4)—Changed to Manage Team.
Control Communications (Section 10.3)—Changed to Monitor
Communications
Control Risks (Section 11.6)—Changed to Monitor Risks.
Plan Stakeholder Management (Section 13.2)—Changed to Plan
Stakeholder Engagement.
Control Stakeholder Engagement (Section 13.4)—Changed to Monitor
Stakeholder Engagement.
X1.12 SECTION 4—PROJECT INTEGRATION MANAGEMENT
CHANGES
A new process, Manage Project Knowledge, was added. This is a result of
many deferred comments from the Fifth Edition indicating the need to address
knowledge management in projects. A key output of this process is the lessons
learned register. This register is used throughout many of the processes in the
Sixth Edition. This emphasizes the need to learn continually throughout the
project rather than waiting until the end to reflect.
Business documents are inputs to the Develop Project Charter and Close
Project or Phase processes. The introduction of business documents underscores
the importance of staying attuned to the business case and benefits management
throughout the project. Administrative closure activities for procurements have
been absorbed into the Close Project or Phase process.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-1 summarizes the Section 4 processes:
Table X1-1. Section 4 Changes
Fifth Edition Processes Sixth Edition Processes
4.1 Develop Project Charter 4.1 Develop Project Charter
4.2 Develop Project Management Plan 4.2 Develop Project Management Plan
4.3 Direct and Manage Project Work 4.3 Direct and Manage Project Work
4.4 Monitor and Control Project Work 4.4 Manage Project Knowledge
4.5 Perform Integrated Change Control 4.5 Monitor and Control Project Work
4.6 Close Project or Phase 4.6 Perform Integrated Change Control
4.7 Close Project or Phase
X1.13 SECTION 5—PROJECT SCOPE MANAGEMENT
CHANGES
The Sixth Edition team collaborated with The Standard for Business Analysis
to ensure that both foundational standards were aligned, though not duplicative.
No changes to process names were necessary.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented.
X1.14 SECTION 6—PROJECT SCHEDULE MANAGEMENT
CHANGES
Section 6 was renamed from Project Time Management to Project Schedule
Management. Research indicated support for the name change as project
managers do not manage time, they define and manage the project schedule. Due
to the shift in focus and renaming of Project Human Resource Management to
Project Resource Management, the process Estimate Activity Resources was
moved from this Knowledge Area to Project Resource Management. Some agile
concepts were incorporated into the Develop Schedule process. Figures and
associated text were updated to clarify scheduling concepts addressed in the
section.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-2 summarizes the Section 6 processes:
Table X1-2. Section 6 Changes
Fifth Edition Processes Sixth Edition Processes
6.1 Plan Schedule Management 6.1 Plan Schedule Management
6.2 Define Activities 6.2 Define Activities
6.3 Sequence Activities 6.3 Sequence Activities
6.4 Estimate Activity Resources 6.4 Estimate Activity Durations
6.5 Estimate Activity Durations 6.5 Develop Schedule
6.6 Develop Schedule 6.6 Control Schedule
6.7 Control Schedule
X1.15 SECTION 7—PROJECT COST MANAGEMENT CHANGES
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented.
X1.16 SECTION 8—PROJECT QUALITY MANAGEMENT
CHANGES
Academic and market research was conducted regarding the Perform Quality
Assurance process. Research indicated that many of the quality tools and
techniques that were identified previously are not widely used in today's
projects. The profession focuses more on managing quality through the quality
management plan. Thus, the Perform Quality Assurance process shifted focus
and the name was changed to Manage Quality.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-3 summarizes the Section 8 processes:
Table X1-3. Section 8 Changes
Fifth Edition Processes Sixth Edition Processes
8.1 Plan Quality Management 8.1 Plan Quality Management
8.2 Perform Quality Assurance 8.2 Manage Quality
8.3 Control Quality 8.3 Control Quality
X1.17 SECTION 9—PROJECT RESOURCE MANAGEMENT
CHANGES
The Sixth Edition expanded the scope of this section from its previous focus
on human resources to include all resources. To distinguish between human
resources and other resources, the term team resources is used to refer to human
resources and the term physical resources is used to refer to other resources. The
Estimate Activity Resources process was transferred into this Knowledge Area
from Project Schedule Management, and a new process Control Resources was
added. The word “project” was eliminated from Develop Team and Manage
Team as it is inferred that the only team the project manager is concerned about
developing and managing is the project team.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-4 summarizes the Section 9 processes:
Table X1-4. Section 9 Changes
Fifth Edition Processes Sixth Edition Processes
9.1 Plan Human Resource Management 9.1 Plan Resource Management
9.2 Acquire Project Team 9.2 Estimate Activity Resources
9.3 Develop Project Team 9.3 Acquire Resources
9.4 Manage Project Team 9.4 Develop Team
9.5 Manage Team
9.6 Control Resources
X1.18 SECTION 10—PROJECT COMMUNICATIONS
MANAGEMENT CHANGES
A subtle but important distinction was made in this section about project
communication. The term “communication” indicates the act of communicating,
such as facilitating a meeting, giving information and active listening. The term
“communications” indicates the artifacts of communication, such as memos,
presentations, and emails. Because it is not possible to control how and when
people communicate, the name of the Control Communications process has been
changed to Monitor Communications.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-5 summarizes the Section 10 processes:
Table X1-5. Section 10 Changes
Fifth Edition Processes Sixth Edition Processes
10.1 Plan Communications Management 10.1 Plan Communications Management
10.2 Manage Communications 10.2 Manage Communications
10.3 Control Communications 10.3 Monitor Communications
X1.19 SECTION 11—PROJECT RISK MANAGEMENT
CHANGES
An increased emphasis on overall project risk was integrated throughout the
risk management processes. A new process, Implement Risk Responses, was
added. This process is part of the Executing Process Group. The new process
emphasizes the importance of not just planning risk responses, but implementing
them as well. A new risk response “escalate” was introduced to indicate that if
risks are identified that are outside the scope of the project objectives, they
should be passed to the relevant person or part of the organization. Because risks
are uncertain future events or conditions, they cannot be controlled; however,
they can be monitored. Thus, the process Control Risks was renamed to Monitor
Risks.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-6 summarizes the Section 11 processes:
Table X1-6. Section 11 Changes
Fifth Edition Processes Sixth Edition Processes
11.1 Plan Risk Management 11.1 Plan Risk Management
11.2 Identify Risks 11.2 Identify Risks
11.3 Perform Qualitative Risk Analysis 11.3 Perform Qualitative Risk Analysis
11.4 Perform Quantitative Risk Analysis 11.4 Perform Quantitative Risk Analysis
11.5 Plan Risk Responses 11.5 Plan Risk Responses
11.6 Control Risks 11.6 Implement Risk Responses
11.7 Monitor Risks
X1.20 SECTION 12—PROJECT PROCUREMENT
MANAGEMENT CHANGES
Much of the information in this Knowledge Area was updated to reflect a
more global perspective. Many projects are conducted with stakeholders in
various countries, or by organizations with offices in multiple countries.
Market research shows that very few project managers actually close out
procurements. Someone in contracts, procurement or legal departments usually
has that authority. Therefore, information from Close Procurements about
evaluating all completed deliverables and comparing them to the contract was
absorbed into Control Procurements. Information about administrative,
communications, and records was moved to Close Project or Phase.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-7 summarizes the Section 12 processes:
Table X1-7. Section 12 Changes
Fifth Edition Processes Sixth Edition Processes
12.1 Plan Procurement Management 12.1 Plan Procurement Management
12.2 Conduct Procurements 12.2 Conduct Procurements
12.3 Administer Procurements 12.3 Control Procurements
12.4 Close Procurements
X1.21 SECTION 13—PROJECT STAKEHOLDER
MANAGEMENT CHANGES
In keeping with current research and practice, a shift was made to focus on
stakeholder engagement rather than stakeholder management. Because project
managers rarely, if ever, have the ability to control stakeholders, Control
Stakeholder Engagement was renamed to Monitor Stakeholder Engagement.
Changes consistent with information described in Sections X1.1 through
X1.11 were implemented. Table X1-8 summarizes the Section 13 processes:
Table X1-8. Section 13 Changes
Fifth Edition Processes Sixth Edition Processes
13.1 Identify Stakeholders 13.1 Identify Stakeholders
13.2 Plan Stakeholder Management 13.2 Plan Stakeholder Engagement
13.3 Manage Stakeholder Engagement 13.3 Manage Stakeholder Engagement
13.4 Control Stakeholder Engagement 13.4 Monitor Stakeholder Engagement
X1.22 GLOSSARY
The glossary of the PMBOK® Guide—Sixth Edition was updated to clarify
meaning and improve the quality and accuracy of any translations. Terms that
are not used in the Sixth Edition, or are not used differently from everyday
usage, were eliminated.
1 Project Management Institute. 2016. The PMI Lexicon of Project
Management Terms. Available from http://www.pmi.org/Lexiconterms
APPENDIX X2
CONTRIBUTORS AND REVIEWERS OF THE
PMBOK® GUIDE—SIXTH EDITION
PMI volunteers first attempted to codify the Project Management Body of
Knowledge in the Special Report on Ethics, Standards, and Accreditation,
published in 1983. Since that time, other volunteers have come forward to
update and improve that original document and contribute to this globally
recognized standard for project management, PMI's A Guide to the Project
Management Body of Knowledge (PMBOK® Guide). This appendix lists, those
individuals who have contributed to the development and production of the
PMBOK® Guide – Sixth Edition. No list can adequately portray all the
contributions of those who have volunteered to develop the PMBOK® Guide –
Sixth Edition.
The Project Management Institute is grateful to all of these individuals for
their support and acknowledges their contributions to the project management
profession.
X2.1 PMBOK® GUIDE—SIXTH EDITION CORE COMMITTEE
The following individuals served as members, were contributors of text or
concepts, and served as leaders within the Project Core Committee:
Cyndi Snyder Dionisio, MBA, PMP, Chair
David A. Hillson, PhD, PMI Fellow, HonFAPM, Vice Chair (Volunteer
Engagement Lead & Section 11 Lead)
Lynda Bourne, DPM, FACS (Sections 10 & 13 Lead)
Larkland A. Brown, PMP, PMI-ACP (Section 6 Lead)
Pan C.P. Kao, PhD, PMP, (Sections 7 & 12 Lead)
Mercedes Martinez Sanz, PMP (Section 4 Lead)
Alejandro Romero-Torres, PhD, PMP, (Document Quality & Management
Lead & Section 5 Lead)
Guy Schleffer, PfMP, PMP, (Sections 8 & 9 Lead)
Michael J. Stratton, PhD, PMP (Section 1, 2, & 3 Lead)†
Kristin L. Vitello, Standards Project Specialist
Gwen Whitman, EMBA, PfMP (Project Communications Lead)
X2.2 SIGNIFICANT CONTRIBUTORS
In addition to the members of the Project Core Committee, the following
individuals provided significant input or concepts:
Ernest Baker, PMP, PRINCE2® Practitioner
Cheryl Burcham, PMP
Guido Caciagli, B., PMP
Jimmy I. Char, PMP, SDI
Cătălin-Teodor Dogaru, PhD, MBA
Andrés Falcón, PMP
Anna Maria Felici, PMP
Eren Gokce, MBA, PMP
Pamela S. Goodhue, MBA, PMP
Franco R. Graziano, MPA, PMP
Joy Gumz, CPA, PMP
Salah M. Haswah, PMP, PgMP
Puja Kasariya, PMP
Srikanth Krishnamoorthy, PMP, PGDSA
Tom Magee, MBA, PMP
David A. Maynard, MBA, PMP
Bob Mahler, PMP, PMI-RMP
Frank R. Parth, MBA, PMP
Dattatraya Y. Pathak, PMP, PfMP
Judy Payne, PhD, MBA
Nagy Attalla Saad, PMP, ITIL
Davidov Shai
Kavita Sharma, PMP, RMP
Jurgen T. Sturany, PMP
Dirk Withake, PgMP, PMP
X2.3 PMBOK® GUIDE—SIXTH EDITION CONTENT
COMMITTEE
The following individuals were contributors of text or concepts and provided
recommendations on drafts of the PMBOK® Guide—Sixth Edition:
Vahid Azadmanesh, MBA, PMP
Brad Bigelow, PMP, MSP
Wayne R. Brantley, MSEd, PMP
Marcelo A. Briola PhD, PMP
Michael C. Broadway, PMP
Mariana Nella Caffarena Bolivar
Steven Flannes
Sandra Fonseca, PhD, CISA, CRISC
Theofanis C. Giotis, PMP, PMI-ACP
Piyush Govil, BE, PMP
Rex M. Holmlin, PE, PMP
Éamonn V. Kelly, DBA, PMP
Srikanth Krishnamoorthy
Fabiano de Alcântara de Lima, PhD, PMP
Shashank Neppalli
Andrea Pantano
Kristine Persun, PMP
Piyush Prakash PMP, Prince 2
Raju N. Rao, PMP, SCPM
Krupakar Reddy, PMP, PRINCE2 Practitioner
Emadeldin Seddik, PhD, PMP
Tejas V. Sura, PMP, PfMP
Nicholas Tovar
Fede Varchavsky, MBA, PMP
Angelo Valle, PhD, CRK
Ronald H. Verheijden, PMP
X2.4 REVIEWERS
X2.4.1 SME REVIEW
In addition to the members of the Committee, the following individuals
provided their review and recommendations on drafts of the standard:
David P. Bieg, PMI-PBA
James F. Carilli, PMP, PgMP
Shika Carter, PMP, PgMP
Dan Deakin, PMP, CISSP
Theofanis C. Giotis, PMP, PMI-ACP
Dave Gunner, MSc, PMP
George Jucan, PMP
Ginger Levin, PhD, PMP, PgMP
Vanina Mangano, PMP, PMI-RMP
Juan Carlos Moreno, MBA, PMP
Marvin R. Nelson, MBA, SCPM
Klaus Nielsen, MBA, PMP
Chris Richards, PMP
Ivan Rincon, MBA, PMP
Shaligram Pokharel, REng (Nepal), PhD
Paul E. Shaltry, MA, PMP
Carolina Gabriela Spindola, PMP, SSBB
Langeswaran Supramaniam, C Build E FCABE, PMP
Michael A Yinger
X2.4.2 FINAL EXPOSURE DRAFT REVIEW (STANDARD
PORTION)
In addition to the members of the Committee, the following individuals
provided recommendations for improving the Exposure Draft of the PMBOK®
Guide—Sixth Edition (standard portion):
Ahmed A. Raouf Hamdy, PhD, PMP
Farhad Abdollahyan, PMP, OPM3 CP
Adil Abdulghani
Tetsuhide Abe, PMP
Klaus Abert
Ayodeji R. Abitogun, MBA, PMP
Taiwo Abraham
Mohammad I. Abu Irshaid, PMP, PfMP
Manuel Acosta A.
Phill C. Akinwale, MSc, PMP
Mazen Al Bazreh
Jose Rafael Alcala Gomez, PMP
Ameer Ali
Hammam Zayed Alkouz, PMP, PMI-RMP
Bill Allbee, PMP
Charmaine Y. Allen, PMP, PBA
Kristin L. Allen, PE, PMP
Abdulaziz Almalki
Ayman Alminawi, MBA, PMP
Ahmad Moh. Al-Musallami, MSc, PMP
Imad Alsadeq, P3M3, MB
Mohammed Ahmad S. Al-Shamsi, PhD, PEng
Essam Alsultan, MBA, PMP
Haluk Altunel, PhD, PMP
Priscilla S. R. Alves, PMP
Angelo Amaral
Barnabas Seth Amarteifio, PMP, ITIL (Expert)
Wilson Anandaraj, MBA, PMP
Guillermo Anton
John Aogon, PMP
Hamid Aougab, PMP, PMI-ACP
Charalampos Apostolopoulos, PhD, PMP
Rodolfo Arguello
Abd Razak B Ariffin, PMP
Deepak Arora, MBA, PMP
C. H. ArunPrabu, PMP
Zaher Asfari, MBA, PMI-ACP
Ayman Atallah, BE, PMP
Reza Atashfaraz, MSc, PMP
Sharaf A. Attas, PMP, PMI-RMP
Abdurazaq Attuwaijri
Ashraf M Awwad, MSc, PMP
Vikram Kumar B. T.
Nabeel Eltyeb Babiker, PMP, P3O
Mohamed A Badie, PMP, Prince2 Practitioner
Smitha Balakrishnan
Saket Bansal, PMP, PMI-ACP
Manuel F. Baquero V., MSc, PMP
Haytham Baraka, PMP, CCP
Robert Barclay
Karuna Basu
Joy Beatty, PMI-PBA, CBAP
Frances Bellows, PMP, ACP
Peter G. Bembir, MPhil, PMP
Anis Ben Hassen, Msc Project/Programme/Portfolio Management, PMP
Racquel Benedict
German Bernate, MPM
Bryan D. Berthot, MBA, PMP
Karl F. Best, PMP, CStd
Shantanu Bhamare, PMP, LIMC
Jasbir Singh Bhogal, PMP, ITIL-V3
Michael M. Bissonette, MBA, PfMP
Molly Blake-Michaels, MS, PMP
Nigel Blampied, PE, PMP
Wolfgang Blickle, PMP, PMI-ACP
Jaqueline Boeck
Dennis L. Bolles, PMP
Kiron D. Bondale, PMP, PMI-RMP
Raúl Borges, PMP
Farid F. Bouges, PhD, PMP, PfMP
Joao Boyadjian
Damiano Bragantini, PMP
Ralf Braune
Kevin Brennan
Naga Pradeep Buddhavarapu, PMP
David E. Buehler, PMP
Susan M. Burk
Andrea Caccamese, PMP, Prince2 Practitioner
Roberto A. Cadena Legaspi, PMP, MCI
Shawna D. Camp, MBA, PMP
Iker Castillo, PMP
Igor Castro
Helena Cedersjö, MSc, PMP
Balasubramanian Chandrasekaran, BE, PMP
Joo-Kwan Chang
Panos Chatzipanos, PhD, Dr Eur Ing
Pengzhi Chen, PMP, MSC
Wilson Lee Chung, PMP
Xavier Clerfeuille, MSc, SSL Black Belt
Martin A. Collado, PMP, ITIL
Sergio Luis Conte, PhD, PMP
Lawrence (Larry) Cooper, PMP, PMI-ACP
Hélio R. Costa, DSc
Scott Cunningham
Adriano Jose da Silva Neves
Hernán D'Adamo, MPM, PMP
Michelle Daigle, PMP
Larry C Dalton, PfMP, PgMP
Farshid Damirchilo, MSc
Tran Dang
Teodor Darabaneanu, PMP, MEng
Russell W. Darnall, DM, PMP
Edson G. Freitas, PMP
Jean-Michel de Jaeger, EMBA, PMP
Maria Angela de Souza Fernandes
Allan E. Dean PMP, PgMP
G. Murat Dengiz, PMP
Valerie P. Denney, DBA, PMP
Jacqueline E. Dennis, PMP, PgMP
Konika Dey, MCA, PMP
Cyndi Snyder Dionisio, MBA, PMP
Ajay Kumar Dixit, MBA, B Tech
Roland Doerr, MSc, PMP
Rex Wotan Dominguez Chang
Jorge Duenas-Lozano
Stephen M. Duffield, MPM, CPPD
Josée Dufour, PMP
Darya Duma, PEng, PMP
Keiran J. Dunne, PhD
Awab Elameer, PMP, PMI-SP
Khaled EL-Nakib, MSc, PMP
Yasir Elsadig, PMP, PfMP
Majdi N. Elyyan, PMP, PMI-RMP
Pedro Engrácia
Mark W. Erwin, PMP, PMI-ACP
Behnam Faizabadi, PhD, PMP
Marco Falcao, PMP, PMI-RMP
Puian Masudi Far, PhDc, PMP
Jamil Faraj
Saurater Faraday, PMI-RMP
Fereydoun Fardad, PMP, PRINCE2
Sergio Ferreto Gutiérrez, MPM, MBA
David Foley, MBA
Les Foley, MPM, PMP
Gloria Folle Estrada, PMP
Frank P. Forte, PMP
Laura Franch, PMP
Nestor C. Gabarda Jr., ECE, PMP
Jaime Garcia Castro, PMP
Sam Ghavanloo, PMP
Ing Gustavo Giannattasio MBA, PMP
Sheila Gibbs
Carl M. Gilbert, PMP PfMP
Theofanis Giotis, PhDc, PMP
José Abranches Gonçalves, MSc, PMP
Juan Carlos González, PMP, PMI-ACP
Jean Gouix, PMP, PgMP
Therese Graff
Scott M. Graffius, PMP, CSM
Brian Grafsgaard, PMP, PgMP
Sara Grilli Colombo
Anita Griner
Maxim Grishin, PhD, PMP
Robert C Grove, MBA, PMP
David Guan, PMP
Juan E. Guarache, V, BEng, PMP
Pier Luigi Guida
Vijay Guliani, PMP, PMI-PBA
Tomasz Gutmanski
Omar Haddad, CAPM, PMP
Mustafa Hafizoglu, PMP
Yoshifumi Hamamichi
Simon Harris, PMP, CGEIT
Patti M. Harter, PMP
Sean Shraden Hasley, MSIT-PM
Ahmed Hassan
Akram Hassan, PhD, PMP
Susumu Hayakawa, PMP
Bruce A. Hayes, PMP
Guangcheng He, PMP
David G. Hendrickson, PMP
Barbara Henrich
Baruch Herrera
Sergio Herrera-Apestigue, PMP, P3O
Robert Hierholtz, PhD, MBA, PMP
Robert N. Higgins V, PMP, ITIL Expert
David A. Hillson, PhD, PMI Fellow, HonFAPM
Shirley Hinton, PMP
Kenji Hiraishi, MsE, PMP
Lenora Holmsten, PMP, MPM
Jenny Anne Horst-Martz, JD, PMP
Alfred J. Howard, PMP, ITIL Expert
Cynthia L. Hoxey, PMP
Gheorghe Hriscu, PMP, CGEIT
Ananth HV PMP, CSM
Guillermo A. Ibañez, PMP, ITIL
Victor Manuel Ibanez Salazar, PMP, MA
Waleed Idris
Shuichi Ikeda, PMP
Andrea Innocenti PMP, CGEIT
Can Izgi, PMP
Pablo Jaramillo
Tariq Javed, MS, PMP
Cari Jewell, PMP, MISST
Gabriela Jimenez P.
Icvillajoe Joe
Tony Johnson, PMP, PfMP
Michele J. Jones, PMP
Yves Jordan, PMP
Alisher Kabildjanov, PMP
SS Kanagaraj, PMP, ITIL
Naoki Kasahara, PMP
Arcady Katnikov
Suhail Khaled
Basher Khalil
Aaron Ho Khong, PMP, ITIL Expert
M. Raashid Kiani, PMP, CSM
Taeyoung Kim, PMP
Ariel S. Kirshbom, PMP, ACP
Konstantinos Kirytopoulos, PhD, PMP
Ian Koenig PMP
Athens Kolias, MPM, PMP
Henry Kondo, PMP, PfMP
Maciej Koszykowski, PMP, PMI-RMP
Rouzbeh Kotobzadeh, PMP, PMI-ACP
Srikanth Krishnamoorthy, PMP, PGDSA
Amit Kumar
Devesh Kumar
Pramit Kumar, PMP
Rakesh Kumar, MBA, PMP
Santosh Kumar
S. Y. Satish Kumar
Abhilash Kuzhikat, PMP, CISA
Thierry Labriet
G.Lakshmi Sekhar, PMP, PMI-SP
Boon Soon Lam
Vincent Hiu Sing Lam, PMP
Ruchie Lamba
Deborah Langlois MBA, PMP
Alvaro Latorre,MsC, PMP
Olivier Lazar
Chang-Hee Lee, PMP, CISA
Cheryl G. Lee, PMP, PMI-PBA
Oliver F. Lehmann, MSc, PMP
Michael J Leisegang, PMP
Craig Letavec, PgMP, PfMP
Jean-Pierre Lhomme, PMP
Junquan Liu
Shihan Liu
Tong Liu (James Liu), PhD, PMP
Anand Loganathan, MS
Anand Lokhande, PMP
Nancy Lopez
Samuel López González de Murillo, MPM, PMP
Carlos López Javier, MBA, PMP
Zheng Lou, MBA, PMP
Sérgio Lourenço, PMP, PMI-RMP
Catia Lourenço
Hugo Kleber Magalhães Lourenço, PMP, ACP
Amy S. Lugibihl, PMP
Sergio O. Lugo, MBA, PMP
Vijaya Prasanth M. L., PMP, MCTS
José Carlos Machicao, MSc, PMP
Frederick G. Mackaden, CRISC, PMP
Jas Madhur
Krishan Gopal Maheshwari, PMP, ITILv3 Expert
Konstantinos Maliakas, MSc (PM), PMP
Rich Maltzman, PMP
Vaios Maniotis
Antonio Marino, PMP, PMI-ACP
Gaitan Marius Titi, Eng, PMP
Photoula Markou-Voskou
Lou Marks, PMP
Cristian Martín Corrales, MPM, PMP
Mike McElroy, MHA, PMP
Jon McGlothian, MBA, PMP
William T. McNamara, PMP
Rob D. Meadows, MBA, PMP
Alain Patrick Medenou, PMP, PRINCE2 Practitioner
Lourdes Medina, PMP, PfMP
Peter Berndt de Souza Mello, PMI-SP, PMP
Yan Bello Mendez
Ernst Menet, PMP
Sunil Meshram, PMP
Mohammed M'Hamdi, PMP
Lubomira Mihailova, MBA, PMP
Gloria J. Miller, PMP
Romeo Mitchell, MSc, BSc
Mannan Mohammed, Peng, PMP
Venkatram Vasi Mohanvasi
Ricardo Monteiro
Paula Morais
Maciej Mordaka, PMP
Rachel A. Morris, PMP
Doris Moss
Henrique Moura, PMP, PMI-RMP
Timur Mukharyamov, PhD, PMP
Antonio Muntaner, PMP
Muktesh Murthy, MBA (IS), PMP
Lemya Musa M. Idris, PMP, PMI-PBA
Khalid M. Musleh, PMP, PMI-RMP
Syed Ahsan Mustaqeem, PE, PMP
Todd Nielsen Myers, MBA, PMP
Narayanaswamy Nagarajan, PMP
Kiran Nalam
Faig Nasibov, PMP
Asad Naveed, PMP, RMP
Serge Patrick N'Guessan, MSIS, PMP
Praveen K. Nidumolu, PMP, PMI-ACP
Eric Nielsen, PMP
Jeffrey S. Nielsen, PMP, PgMP
Víctor Nieva Martín-Portugués, PMP
Michael C. Nollet, PMP, PMI-ACP
Takamasa Nomura
Ernesto Antonio Noya Carbajal
Mufaro M. Nyachoto, PMI-PBA, CAPM
Conor O'Brien, MBA (Tech Open), PMP
Peter O'Driscoll
Michael O. Ogberuhor, PMP, EVP
Bayonle Oladoja, PMP, PRINCE2
Antonio Oliva González, PMP, EMPM
Habeeb Omar, PgMP, PfMP
Stefan Ondek, PMP
Marian Oprea, PMP, ITIL
Henrique Ortega-Tenorio, PMP
Venkateswar Oruganti, FIETE, PMP
Musab Abdalmageed Osman Abubakar
Jaime Andres Alvarez Ospina, PMP, PMI-RMP
Tabitha A. Palmer, PMP
Neeraj Pandit, PMP
Luke Panezich, PMP, PMI-ACP
Hariyo Pangarso
Laura Paton, PMP, PMI-PBA
Seenivasan Pavanasam, PMP, PgMP
Anil Peer, PEng, PMP
Mauricio Perez Calvo, PMP, PMI-RMP
Dana Persada Mulyoto, MBA, PMP
LEE Nan Phin, PMP, CSM
Luca Pietrandrea
Crispin (“Kik”) Piney, BSc, PgMP
Jose Angelo Pinto, PMP, OPM3 CP
Narendra Pondugula, PMP, PMI-ACP
Hin-Fei Poon
Svetlana Prahova, PMP
B. K. Subramanya Prasad, PMP, CSM
T.V. Prasanna Raaj, PMP
Suhail Qadir, PMP, BTech
Collin Quiring, PMP, OPM3
Nader K. Rad, PMP
Noalur Rahim, PMP
Prashanth Bagepalli Rajarao, BE, PMP
S. Ramani, PgMP, PfMP
Gurdev S. Randhawa, PMP
Alakananda Rao
Vicky Restrepo, PMP
Raman Rezaei
Tashfeen Riaz, PMP, MPM
Juan Carlos Rincón Acuña, PhD, PMP
Juan Sebastian Rivera Ortiz
Dan Roman, PMP, PMI-ACP
Rafael Fernando Ronces Rosas, PMP, ITIL
David W. Ross, PMP, PgMP
Kaydashov Ruslan, PMP
Philip Leslie Russell, PMP
Mohamed Salah Eldien Saad, PMP
Eyad Saadeh, PfMP, PgMP
Imad Sabonji, PMP
Kumar Sadasivan, PMP
Mihail Sadeanu, PhD, PMP
Gopal Sahai, PMP, PMI-PBA
Joudi Ahmad Said, PMP, MSc
Ibrahim Saig, PhD, PMP, MRCPI
Brian Salk, PhD, PMP
Omar A. Samaniego, PMP, PMI-RMP
Abubaker Sami, PfMP, PgMP
Carlos Sánchez Golding, PMP
Yiannis Sandis, MSc, PMP
Iván S. Tejera Santana, PMP, PMI-ACP
Murali Santhanam, PMP, BCom
Subhendu Sarangi
Saikat Sarkar, PMP
Shreesh Sarvagya
Supriya Saxena
Nicole Schelter, PMP
Kathy Schwalbe, PhD, PMP
Dion Serben
Marcus Gregorio Serrano, MBA, PMP
Isaac Sethian, MBA, PMP
Bruce G. Shapiro, PMP
Ian Sharpe, 4-DM CPPD
Cindy C Shelton, PMP, PMI-ACP
Nitin Shende, PMP, PRINCE2
Gregory P. Shetler, PhD, PgMP
Patricia C. C. Sibinelli, MEng, PMP
Alexsandro Silva
Christopher M. Simonek, PMP
Rohit Singh
Sathya Sivagurunathan
Venkatramanan S., PMP
Michelle A. Sobers, MS
Pamela L. Soderholm, PMP
Khaled Soliman
Mauro Sotille, PMP, PMI-RMP
Sriram Srinivasan, PMP, CGEIT
Pranay Srivastava, PMP, CSM
Alexander Stamenov
Jamie Stasch
John Stenbeck, PMP, PMI-ACP
Michael J. Stratton, PhD, PMP
S. Sudha, PMP
John L. Sullivan, MEd, PMP
Karen Z. Sullivan, PMP, PSM
Surichaqui Yasuji Suzuki, PMP
Mark A. Swiderski, PMP, MBA
Titus K. Syengo, PMP
Paul S. Szwed, DSc, PMP
Hadi Tahmasbi Ashtiani
Shoji Tajima, PMP, ITC
Peter Tashkoff, PMP
Ahmet Taspinar
Gokrem Tekir
Sunil Telkar PMP, PGDBL
Sal J. Thompson, MBA, PMP
Mark S. Tolbert, PMP, PMI-ACP
Mukund Toro, PMP
Stephen Tower, PMP, MBCI
John Tracy, PMP, MBA
Biagio Tramontana, Eng, PMP
Micol Trezza, MBA, PMP
Konstantin Trunin, PMP
Ahmet Tümay, PhD, PMP
M. Jeffery Tyler, PMP
Hafiz Umar, MBA, PMP
Krishnakant T. Upadhyaya, PMP
Atta Ur Rahman, MBA, PMP
Ebenezer Uy
Madhavan V.
Ali Vahedi Diz, PgMP, PfMP
Tom Van Medegael, PMP
Stephen VanArsdale
Enid T. Vargas Maldonado, PMP, PMI-PBA
Paola D. Vargas
Allam V. V. S. Venu, PMP, PgMP
Roberto Villa, PMP
Tiziano Villa, PMP, PMI-ACP
Benjamin Villar Lurquin, Bs
Dave Violette, MPM, PMP
Vijay Srinivas Vittalam PMP, RMP
Julian Vivas
Sameh Wahba, PMP, CPMC
Prakash Waknis, PMP
Xiaojin Wang, PhD, PMP
Tsunefumi Watanabe, PMP
Barbara A. Waters, MBA, PMP
Shayla P. Watson, MA
Patrick Weaver, PMP, PMI-SP
Kevin R. Wegryn, PMP, Security+
Lars Wendestam, MSc, PMP
Jan Werewka, PMP
Carol E. P. Whitaker, MBA, PMP
Sean Whitaker, MBA, PMP
Angela Wick, PMP, PBA
Michal P. Wieteska
J. Craig Williams
Malgorzata Wolny
Sek-Kay Steve Wong, MBA, PMP
Louise M. Worsley
Yan Wu, APME, PMP
Clement C. L. Yeung, PMP
Cynthia J. Young, PhD, PMP, LSSMBB
Gordon Young
Alan E. Yue, PMP, PMI-ACP
Hany I. Zahran
Saeed Zamani
Alessandri Zapata Rosas, PMP
Azam M. Zaqzouq, MCT, PMP
Salim Zid, MSc, PMP
Eire Emilio Zimmermann
Marcin Zmigrodzki, PhD, PgMP
X2.4.3 FINAL EXPOSURE DRAFT REVIEW (GUIDE PORTION)
In addition to the members of the Committee, the following individuals
provided recommendations for improving the Exposure Draft of the PMBOK®
Guide—Sixth Edition (guide portion):
Farhad Abdollahyan, PMP, OPM3CP
Tetsuhide Abe, PMP
Ali Abedi, PhD, PMP
Amir Mansour Abdollahi, MSc, PE
Eric Aboagye
Umesh AC
Jer Adamsson
Carles Adell, MPM, PMP
Mounir A. Ajam, RMP, GPM-bTM
Uğur Aksoylu, PMP
Tarik Al Hraki, PMP, PMI-RMP
Melad Al Aqra, PMP, MIET
Amer Albuttma, BSc, PMP
Jose Rafael Alcala Gomez, PMP
Filippo Alessandro, PMP
Hammam Zayed Alkouz, PMP, PMI-RMP
Eric Allen
Wasel A. Al-Muhammad, MBA, PMP
Turki Mohammed Alqawsi, MITM
Imad Alsadeq, MB, P3M3
Haluk Altunel, PhD, PMP
Barnabas Seth Amarteifio, PMP, ITIL (Expert)
Serge Amon, MBA, PMP
Abd Razak B Ariffin, PMP
Sridhar Arjula
Kalpesh Ashar, PMP, PMI-ACP
Vijaya C. Avula, PMP, ACP
Andy Bacon, PMP, CSP
Andrey Badin
Sherif I. Bakr, PMP, MBA
Karuna Basu
Chandra Beaveridge, BEng, PMP
Jane Alam Belgaum, PMP
Stefan Bertschi, PhD
Harwinder Singh Bhatia, PMP, PMI-ACP
Jasbir Singh Bhogal, PMP, ITIL-V3
Jayaram Bhogi PMP, CSM
Michael M. Bissonette, MBA, MS
Greta Blash, PMP, PMI-ACP
Steve Blash, PMP, PMI-ACP
Dennis L. Bolles, PMP
Rodolphe Boudet, PMP
Farid F. Bouges, PhD, PfMP, PMP
Damiano Bragantini, PMP
Ralf Braune, PhD, PMP
Maria del Carmen Brown, PMP
James N. Bullock, PMP, ASQ CMQ/OE
Andy Burns PMP, PMI-ACP
Nicola Bussoni, PMP
Roberto A. Cadena Legaspi, PMP, MCI
Carla M. Campion, BEng (Hons), PMP
Shika Carter, PMP, PgMP
Luis Casacó, MA, PMP
Guillermo A. Cepeda L., PMP, PMI-RMP
Kristine Chapman
Panos Chatzipanos, PhD, Dr Eur Eng.
Satish Chhiba
Aditya Chinni
Virgiliu Cimpoeru, PhDc, PMP
Jorge Omar Clemente, PMP, CPA
Martin A. Collado, PMP, ITIL
Sergio Luis Conte, PhD, PMP
Franco Cosenza, PGDipBA, PMP
Veronica Cruz
Ron Cwik MBA, PMP
Yudha P. Damiat, PMP, PMI-SP
Farshid Damirchilo, MSc
William H. Dannenmaier, PMP, MBA
Sankalpa Dash
Gina Davidovic PMP, PgMP
Beatriz Benezra Dehtear, MBA
G. Murat Dengiz, PMP
Stephen A. Devaux, PMP, MSPM
Shanmugasundaram Dhandapani
Sachin S. Dhaygude, PMP, PMI-ACP
Ivana Dilparic
Marcelo Sans Dodson, DBA,PMP
Nedal A. Dudin, PMP, PBA
Jorge A. Dueñas, PMP, AVS
Eunice Duran Tapia, PMP, PfMP
Wael K. Elmetwaly, PMP, PMI-ACP
Talha M. El-Gazzar, PMP
Carol Elliott, MBA, PMP
Larry Elwood, PMP, CISSP
Angela England
Marco Falcao, PMP, PMI-RMP
Puian Masudi Far, PhDc, PMP
Jared Farnum
Jose L. Fernandez-Sanchez, PhD
Eduardo S. Fiol, PMP
Regis Fitzgibbon
Garry Flemings
Carlos Augusto Freitas, CAPM, PMP
Scott J. Friedman, PMP, ACG
MAG Sanaa Fuchs
Nestor C. Gabarda Jr., ECE, PMP
Robert M. Galbraith, PMP
Carl M. Gilbert, PMP, PfMP
Theofanis Giotis, PhDc, PMP
Dhananjay Gokhale
José Abranches Gonçalves, MSc, PMP
Herbert G. Gonder, PMP
Edward Gorni, PMP, MSc
Julie Grabb PMP, B Math
Stuart Gray
Christiane Gresse von Wangenheim, Dr. rer. nat., PMP
Grzegorz Grzesiak
Ahmed Guessous, PMP
Neeraj Gupta, PMP, CSM
Sunita Gupta
Raj Guttha PhD, PMP
Mustafa Hafizoglu, PMP
Kazuro Haga, PMP, PMI-RMP
Yoshifumi Hamamichi
Simon Harris, PMP, CGEIT
Gabrielle B. Haskins, PMP
Hossam Hassan
Madhavi Hawa, MBA
Randell R. Hayes II, PMP, MBA
Guangcheng He, PMP
Kym Henderson, RFD, MSc (Comp)
Sergio Herrera-Apestigue, PMP, P3O
Robert Hierholtz, PhD, MBA, PMP
Bob Hillier, PMP
Aaron Ho Khong, PMP, ITIL Expert
Scott C. Holbrook, PMP, CISSP
Regina Holzinger, PhD, PMP
Christina M. House, MBA, PMP
Gheorghe Hriscu, PMP, CGEIT
Terri Anne Iacobucci, SPHR, PMP
Guillermo A. Ibañez, PMP, ITIL
Can Izgi, PMP
Anand Jayaraman PMP, MCA
Anil K. Jayavarapu, PMP
Cari Jewell, PMP, MISST
Martina Jirickova
Alan John
Tony Johnson, PMP, PfMP
Michele J. Jones, PMP
Rajesh G. Kadwe, PMP
Orhan Kalayci, PMP, CBAP
Samer Faker Kamal, PMP, LEED AP BD+C
Surendran Kamalanathan
Vaijayantee Kamat, PMP
Nils Kandelin
Carl Karshagen, PMP
Anton Kartamyshev
Scott Kashkin, MS, PMP
Katsuichi Kawamitsu, PMP, ITC
Rachel V. Keen, PMP
Suhail Khaled
Jamal Khalid
Eng. Ahmed Samir Khalil, PMP, OPM3-CP
Basher Khalil
Ranga Raju Kidambi
Mostafa K. Kilani, BEng, PMP
Diwakar Killamsetty
Taeyoung Kim, PMP
Konstantinos Kirytopoulos, PhD, PMP
Kashinath Kodliwadmanth
Maarten Koens, PMP
Dwaraka Ramana Kompally, MBA, PMP
Henry Kondo, PMP, PfMP
Maciej Koszykowski, PMP, PMI-RMP
Ahmed A F Krimly
Srikanth Krishnamoorthy, PMP, PGDSA
Bret Kuhne
Avinash Kumar, PMP
Pramit Kumar, PMP
Thomas M. Kurihara
Andrew Lakritz
Boon Soon Lam
Luc R. Lang PMP
Jon Lazarus
Chang-Hee Lee PMP, CISA
Ivan Lee PMP, PMI-ACP
Oliver F. Lehmann, MSc, PMP
Katherine A. Leigh
Donald LePage
Peter Liakos, PMP, Cert APM
Tong Liu, PhD, PMP
Chandra Sekhar Lolla Venkata Satya
Stefania Lombardi, PhDc, PMP
Daniel D. Lopez, CSP, PMP
Zheng Lou, MBA, PMP
Sérgio Lourenço, PMP, PMI-RMP
Hugo Kleber Magalhães Lourenço, PMP, ACP
Xiang Luo, PMP, PMI-PBA
José Carlos Machicao, PMP, MSc
Sowjanya Machiraju, MS, PMP
Robert Mahler
Mostafa M. Abbas, PMP, OCE
Konstantinos Maliakas, MSc (PM), PMP
Rich Maltzman, PMP
Ammar Mango
Antonio Marino, PMP, PMI-ACP
Gaitan Marius Titi, Eng, PMP
Lou Marks, PMP
Rodrigo Marques da Rocha
Ronnie Maschk, PMP
Maria T Mata-Sivera, PMP
Kurisinkal Mathew
Stephen J. Matney, CEM, PMP
David A. Maynard, MBA, PMP
Pierre Mbeniyaba Mboundou
Thomas McCabe
Jon McGlothian, MBA, PMP
Alan McLoughlin, PMP, PMI-ACP
Ernst Menet, PMP
Mohammed M'Hamdi, PMP
Roberta Miglioranza, PMP, Prince2
Gloria J. Miller, PMP
Daniel Minahan, MSPM, PMP
Javier A Miranda, PMP, PMI-ACP
Saddam Mohammed Babikr Mohammed
Venkatramvasi Mohanvasi, PMP
Maciej Mordaka, PMP
Paola Morgese, PMP
Moises Moshinsky, MSc, PMP
Henrique Moura, PMP, PMI-RMP
Nathan Mourfield
Alison K. Munro, MSc, PMP
Khalid M. Musleh, PMP, PMI-RMP
Vasudev Narayanan
Faig Nasibov, PMP
Daud Nasir, PMP, LSSBB
Nasrullah
Nghi M. Nguyen, PhD, PMP
Eric Nielsen, PMP
Yamanta Raj Niroula, PMP
Emily Nyindodo
Peter O'Driscoll
Kiyohisa Okada
Bayonle Oladoja, PMP, PRINCE2
Sofia Olguin
Edward C. Olszanowski III, PMP, EMBA
Austen B. Omonyo, PhD, PMP
Stefan Ondek, PMP
Tom Oommen
H. Metin Ornek, PMP, MBA
Juan Carlos Pacheco
Durgadevi S. Padmanaban, MBA, PMP
Ravindranath Palahalli
Boopathy Pallavapuram, PMP
Rajeev R. Pandey
Luke Panezich, PMP, PMI-ACP
Sungjoon Park, PMP
Gino Parravidino Jacobo, PMP, ITIL
Richard L. Pascoe, PMP
George Pasieka, PMP
Sneha Patel, PMP
Satyabrata Pati, PMP
Seenivasan Pavanasam PMP, PgMP
R. Anthoney Pavelich, PMP
P. B. Ramesh, PMP, ACP
Brent C. Peters, BA
Yvan Petit, PhD, PMP
Crispin (“Kik”) Piney, BSc, PgMP
Jose Angelo Pinto, PMP, OPM3 CP
Napoleón Posada, MBA, PMP
B K Subramanya Prasad, PMP, CSM
Carl W. Pro, PMP, PMI-RMP
Srikanth PV
Nader K. Rad, PMP
Karen Rainford, EdD, PMP
S. Ramani, PfMP, PgMP
Niranjana Koodavalli Ramaswamy, BE Mech, PGDM
Jesus Esteban Ramirez, BEng, eCS
Michele Ranaldo, PMP
Gurdev S. Randhawa, PMP
Sreekiran K. Ranganna, PMP, MBA
Alakananda Rao
Muhammad Sauood ur Rauf, PMP
P. Ravikumar, PMP, PMI-ACP
Michael Reed, PMP, PfMP
Messias Reis, PMP
Alexander V. Revin, PMP
Mohammadreza Rezaei
Gustavo Ribas
David B. Rich, PMP
Gregg D. Richie, PMP, MCTS
Edgar Robleto Cuadra
Bernard Roduit
David Roe, PMP
Rafael Fernando Ronces Rosas, PMP, ITIL
Prakash Roshan
William S. Ruggles, PMP, CSSMBB
Nagy Attalla Saad, PMP, ITIL
Natesa Sabapathy, PhD, PMP
Kumar Sadasivan, PMP
Dzhamshid Safin, PhD, PMP
Edgardo S. Safranchik, PMP
Ibrahim Mohammed Ali Saig
Naoto Sakaue
Xavier Salas Ceciliano, MSc, PMP
Anderson Sales
Floriano Salvaterra, PMP, IPMA-C
Omar A. Samaniego, PMP, PMI-RMP
Abubaker Sami, PfMP, PgMP
Angela Sammon
P. Sampathkumar, MBA, PMP
Iván S. Tejera Santana, PMP, PMI-ACP
Luciana de Jesus Santos, PMP
Aminu Sarafa, PMP, CCP
Darpan Saravia, PMP, CSM
Tamara Scatcherd
Stephen M. Schneider, PhD, PMP
Ludwig Schreier, Eur Ing, PMP
Birgitte Sharif, PMP
Sanjeev Sharma
Alexander Shavrin, PhD, PMP
Nitin Shende, PMP, PRINCE2
Luqman Shantal, PMP, TOGAF
N. K. Shrivastava, PMP, SPC4
Mohamad Sibai
Gustavo Silva
Sumit Kumar Sinha, PMP
Ronald Zack Sionakides, MBA, PMP
Klas Skogmar, EMBA, PMP
J. Greg Smith, EVP
Kenneth F. Smith, PhD, PMP
Pamela L. Soderholm, PMP
John Paul Soltesz
Sheilina Somani, RPP, PMP
Mauro Sotille, PMP, PMI-RMP
Setty Sreelatha, PMP, PMI-ACP
Shishir Srivastav, PMP, CSM
Pranay Srivastava, PMP, CSM
John Stenbeck, PMP, PMI-ACP
Jim Stewart
Yasuji Suzuki, PMP
Mark A. Swiderski, PMP, MBA
Ahmed Taha, PMP, PMI-RMP
Francis Taiwo, PMP, PMI-ACP
Yahya Tatar, PMP, MBA
Gerhard J. Tekes, PMP, PMI-RMP
Gokrem Tekir
João Paulo Tinoco
Claudia A. Tocantins, MSc, PMP
Mukund Toro, PMP
Juan Torres Vela
Stephen Tower, PMP, MBCI
Brenda Tracy
John Tracy, MBA, PMP
Konstantin Trunin, PMP
Tassos Tsochataridis, MSc, PMP
Krishnakant T. Upadhyaya, PMP
Ali Vahedi Diz, PgMP, PfMP
Jorge Valdés Garciatorres, PMP, SMC
Jose Felix Valdez-Torero, PMP
Tom Van Medegael, PMP
Raymond Z van Tonder, PMP, ND Elec Eng
Ravi Vanukuru, BE, PMP
Ricardo Viana Vargas, MSc, PMP
Neelanshu Varma, PMP
Debbie Varn, PMP, SHRM-SCP
Vijay Vemana, PgMP, PMP
Nagesh V., PMP
Aloysio Vianna Jr., DEng, PMP
Roberto Villa, PMP
Jorge Villanueva, MSc (PM), PMP
Dave Violette, MPM, PMP
Yiannis Vithynos PMP, PMI-ACP
Steve Waddell, MBA, PMP
Xiaojin Wang, PhD, PMP
J. LeRoy Ward, PMP, PgMP
Toshiyuki Henry Watanabe, PE, PMP
Ashleigh Waters, PMP
Ganesh Watve, MBA, PMP
Patrick Weaver, PMP, PMI-SP
Michal P. Wieteska
Roger Wild, PMP
Rebecca A. Winston, JD
Lisa Wolf
Carlos Magno Xavier, PhD, PMP
Wenyi Xiao, PMP
Haotian Xu, CAPM
Clement C. L. Yeung, PMP
Saeed Zamani
Azam M. Zaqzouq, MCT, PMP
Omran M. Zbeida, PMP, BSP
Marcin Zmigrodzki, PMP, PgMP
Rolf Dieter Zschau, PMP
Alan Zucker, PMP, CSM
X2.5 PMI STANDARDS PROGRAM MEMBER ADVISORY
GROUP (MAG)
The following individuals served as members of the PMI Standards Program
Member Advisory Group during development of the PMBOK® Guide—Sixth
Edition:
Maria Cristina Barbero, PMP, PMI-ACP
Brian Grafsgaard, PMP, PgMP
Hagit Landman, PMP, PMI-SP
Yvan Petit, PhD, PMP
Chris Stevens, PhD
Dave Violette, MPM, PMP
John Zlockie, MBA, PMP, PMI Standards Manager
X2.6 CONSENSUS BODY REVIEW
The following individuals served as members of the PMI Standards Program
Consensus Body:
Nigel Blampied, PE, PMP
Dennis L. Bolles, PMP
Chris Cartwright, MPM, PMP
Sergio Coronado, PhD
Andrea Demaria, PMP
John L. Dettbarn, Jr., DSc, PE
Charles T. Follin, PMP
Laurence Goldsmith, MBA, PMP
Dana J Goulston, PMP
Brian Grafsgaard, PMP, PgMP
David Gunner, PMP
Dorothy L. Kangas, PMP
Thomas Kurihara
Hagit Landman, PMP, PMI-SP
Timothy MacFadyen
Harold “Mike” Mosley, Jr., PE, PMP
Eric S Norman, PMP, PgMP
Nanette Patton, MSBA, PMP
Yvan Petit, PhD, PMP
Crispin (“Kik”) Piney, BSc, PgMP
Michael Reed, PMP, PfMP
David W. Ross, PMP, PgMP
Paul E. Shaltry, PMP
Chris Stevens, PhD
Adam D. Sykes, MS, PMP
Matthew D. Tomlinson, PMP, PgMP
Dave Violette, MPM, PMP
X2.7 PRODUCTION STAFF
Special mention is due to the following employees of PMI:
Donn Greenberg, Manager, Publications
Roberta Storer, Product Editor
Barbara Walsh, Publications Production Supervisor
†Deceased. The core committee and PMI acknowledge Michael J. Stratton for
his work on the PMBOK Guide-Sixth Edition. Mike was dedicated to the
profession and this work is a testament of his contributions to the field of project
management.
APPENDIX X3
AGILE, ITERATIVE, ADAPTIVE, AND HYBRID
PROJECT ENVIRONMENTS
This appendix explores the nuances of how the Project Management Process
Groups described in The Standard for Project Management are performed with
respect to the project environment and life cycle.
Section 1.4.2.1 of the PMBOK® Guide states that the “project life cycle needs
to be flexible enough to deal with the variety of factors included in the project.”
It is the nature of projects to evolve as more detailed and specific information
becomes available. This ability to evolve and adapt is more relevant in
environments with a high degree of change and uncertainty or with a wide
variation of stakeholder interpretation and expectations.
X3.1 THE CONTINUUM OF PROJECT LIFE CYCLES
To understand the application of the process in adaptive projects, the
continuum of project life cycles should be defined. The PMBOK® Guide
Glossary describes the project life cycle as “the series of phases that a project
passes t
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation
Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation

Mastering Project Management with PMBOK Guide 6th Edition: A Comprehensive Presentation

  • 2.
    A Guide tothe PROJECT MANAGEMENT BODY OF KNOWLEDGE (PMBOK® GUIDE) Sixth Edition This book was printed utilizing a patented anti-counterfeit print technology designed to prevent unauthorized reproductions. The paper color is gray instead of white. When the pages of the book are copied or scanned a hidden warning message will appear in the background. This security feature is intended to discourage anyone from attempting to illegally reproduce or counterfeit this book.
  • 3.
    Library of CongressCataloging-in-Publication Data Names: Project Management Institute, publisher. Title: A guide to the project management body of knowledge (PMBOK guide) / Project Management Institute. Other titles: PMBOK guide Description: Sixth edition. | Newtown Square, PA: Project Management Institute, 2017. | Series: PMBOK guide | Includes bibliographical references and index. Identifiers: LCCN 2017032505 (print) | LCCN 2017035597 (ebook) | ISBN 9781628253900 (ePUP) | ISBN 9781628253917 (kindle) | ISBN 9781628253924 ( Web PDF) | ISBN 9781628251845 (paperback) Subjects: LCSH: Project management. | BISAC: BUSINESS & ECONOMICS / Project Management. Classification: LCC HD69.P75 (ebook) | LCC HD69.P75 G845 2017 (print) | DDC 658.4/04--dc23 LC record available at https://lccn.loc.gov/2017032505 ISBN: 978-1-62825-184-5 Published by: Project Management Institute, Inc. 14 Campus Boulevard Newtown Square, Pennsylvania 19073-3299 USA Phone: +1 610-356-4600 Fax: +1 610-356-4647 Email: customercare@pmi.org Website: www.PMI.org ©2017 Project Management Institute, Inc. All rights reserved. Project Management Institute, Inc. content is copyright protected by U.S. intellectual property law that is recognized by most countries. To republish or reproduce PMI's content, you must obtain our permission. Please go to http://www.pmi.org/permissions for details. To place a Trade Order or for pricing information, please contact Independent Publishers Group: Independent Publishers Group Order Department 814 North Franklin Street Chicago, IL 60610 USA Phone: +1 800-888-4741 Fax: +1 312- 337-5985 Email: orders@ipgbook.com (For orders only) For all other inquiries, please contact the PMI Book Service Center. PMI Book Service Center P.O. Box 932683, Atlanta, GA 31193-2683 USA Phone: 1-866-276-4764 (within the U.S. or Canada) or +1-770-280-4129 (globally) Fax: +1-770-280-4113 Email: info@bookorders.pmi.org Printed in the United States of America. No part of this work may be reproduced or transmitted in any form or by any means, electronic, manual, photocopying, recording, or by any information storage and retrieval system, without prior written permission of the publisher. The paper used in this book complies with the Permanent Paper Standard issued by the National Information Standards Organization (Z39.48—1984).
  • 4.
    PMI, the PMIlogo, PMBOK, OPM3, PMP, CAPM, PgMP, PfMP, PMI-RMP, PMI-SP, PMI-ACP, PMI- PBA, PROJECT MANAGEMENT JOURNAL, PM NETWORK, PMI TODAY, PULSE OF THE PROFESSION and the slogan MAKING PROJECT MANAGEMENT INDISPENSABLE FOR BUSINESS RESULTS. are all marks of Project Management Institute, Inc. For a comprehensive list of PMI trademarks, contact the PMI Legal Department. All other trademarks, service marks, trade names, trade dress, product names and logos appearing herein are the property of their respective owners. Any rights not expressly granted herein are reserved. 10 9 8 7 6 5 4 3 2 1
  • 5.
    NOTICE The Project ManagementInstitute, Inc. (PMI) standards and guideline publications, of which the document contained herein is one, are developed through a voluntary consensus standards development process. This process brings together volunteers and/or seeks out the views of persons who have an interest in the topic covered by this publication. While PMI administers the process and establishes rules to promote fairness in the development of consensus, it does not write the document and it does not independently test, evaluate, or verify the accuracy or completeness of any information or the soundness of any judgments contained in its standards and guideline publications. PMI disclaims liability for any personal injury, property or other damages of any nature whatsoever, whether special, indirect, consequential or compensatory, directly or indirectly resulting from the publication, use of application, or reliance on this document. PMI disclaims and makes no guaranty or warranty, expressed or implied, as to the accuracy or completeness of any information published herein, and disclaims and makes no warranty that the information in this document will fulfill any of your particular purposes or needs. PMI does not undertake to guarantee the performance of any individual manufacturer or seller's products or services by virtue of this standard or guide. In publishing and making this document available, PMI is not undertaking to render professional or other services for or on behalf of any person or entity, nor is PMI undertaking to perform any duty owed by any person or entity to someone else. Anyone using this document should rely on his or her own independent judgment or, as appropriate, seek the advice of a competent professional in determining the exercise of reasonable care in any given circumstances. Information and other standards on the topic covered by this publication may be available from other sources, which the user may wish to consult for additional views or information not covered by this publication. PMI has no power, nor does it undertake to police or enforce compliance with the contents of this document. PMI does not certify, test, or inspect products, designs, or installations for safety or health purposes. Any certification or other statement of compliance with any health or safety-related information in this
  • 6.
    document shall notbe attributable to PMI and is solely the responsibility of the certifier or maker of the statement.
  • 7.
    TABLE OF CONTENTS PART1. A GUIDE TO THE PROJECT MANAGEMENT BODY OF KNOWLEDGE (PMBOK® Guide) 1. INTRODUCTION 1.1 Overview and Purpose of this Guide 1.1.1 The Standard for Project Management 1.1.2 Common Vocabulary 1.1.3 Code of Ethics and Professional Conduct 1.2 Foundational Elements 1.2.1 Projects 1.2.2 The Importance of Project Management 1.2.3 Relationship of Project, Program, Portfolio, and Operations Management 1.2.4 Components of the Guide 1.2.5 Tailoring 1.2.6 Project Management Business Documents 2. THE ENVIRONMENT IN WHICH PROJECTS OPERATE 2.1 Overview 2.2 Enterprise Environmental Factors 2.2.1 EEFs Internal to the Organization 2.2.2 EEFs External to the Organization 2.3 Organizational Process Assets 2.3.1 Processes, Policies, and Procedures 2.3.2 Organizational Knowledge Repositories
  • 8.
    2.4 Organizational Systems 2.4.1Overview 2.4.2 Organizational Governance Frameworks 2.4.3 Management Elements 2.4.4 Organizational Structure Types 3. THE ROLE OF THE PROJECT MANAGER 3.1 Overview 3.2 Definition of a Project Manager 3.3 The Project Manager's Sphere of Influence 3.3.1 Overview 3.3.2 The Project 3.3.3 The Organization 3.3.4 The Industry 3.3.5 Professional Discipline 3.3.6 Across Disciplines 3.4 Project Manager Competences 3.4.1 Overview 3.4.2 Technical Project Management Skills 3.4.3 Strategic and Business Management Skills 3.4.4 Leadership Skills 3.4.5 Comparison of Leadership and Management 3.5 Performing Integration 3.5.1 Performing Integration at the Process Level 3.5.2 Integration at the Cognitive Level 3.5.3 Integration at the Context Level 3.5.4 Integration and Complexity 4. PROJECT INTEGRATION MANAGEMENT
  • 9.
    4.1 Develop ProjectCharter 4.1.1 Develop Project Charter: Inputs 4.1.2 Develop Project Charter: Tools and Techniques 4.1.3 Develop Project Charter: Outputs 4.2 Develop Project Management Plan 4.2.1 Develop Project Management Plan: Inputs 4.2.2 Develop Project Management Plan: Tools and Techniques 4.2.3 Develop Project Management Plan: Outputs 4.3 Direct and Manage Project Work 4.3.1 Direct and Manage Project Work: Inputs 4.3.2 Direct and Manage Project Work: Tools and Techniques 4.3.3 Direct and Manage Project Work: Outputs 4.4 Manage Project Knowledge 4.4.1 Manage Project Knowledge: Inputs 4.4.2 Manage Project Knowledge: Tools and Techniques 4.4.3 Manage Project Knowledge: Outputs 4.5 Monitor and Control Project Work 4.5.1 Monitor and Control Project Work: Inputs 4.5.2 Monitor and Control Project Work: Tools and Techniques 4.5.3 Monitor and Control Project Work: Outputs 4.6 Perform Integrated Change Control 4.6.1 Perform Integrated Change Control: Inputs 4.6.2 Perform Integrated Change Control: Tools and Techniques 4.6.3 Perform Integrated Change Control: Outputs 4.7 Close Project or Phase
  • 10.
    4.7.1 Close Projector Phase: Inputs 4.7.2 Close Project or Phase: Tools and Techniques 4.7.3 Close Project or Phase: Outputs 5. PROJECT SCOPE MANAGEMENT 5.1 Plan Scope Management 5.1.1 Plan Scope Management: Inputs 5.1.2 Plan Scope Management: Tools and Techniques 5.1.3 Plan Scope Management: Outputs 5.2 Collect Requirements 5.2.1 Collect Requirements: Inputs 5.2.2 Collect Requirements: Tools and Techniques 5.2.3 Collect Requirements: Outputs 5.3 Define Scope 5.3.1 Define Scope: Inputs 5.3.2 Define Scope: Tools and Techniques 5.3.3 Define Scope: Outputs 5.4 Create WBS 5.4.1 Create WBS: Inputs 5.4.2 Create WBS: Tools and Techniques 5.4.3 Create WBS: Outputs 5.5 Validate Scope 5.5.1 Validate Scope: Inputs 5.5.2 Validate Scope: Tools and Techniques 5.5.3 Validate Scope: Outputs 5.6 Control Scope 5.6.1 Control Scope: Inputs 5.6.2 Control Scope: Tools and Techniques 5.6.3 Control Scope: Outputs
  • 11.
    6. PROJECT SCHEDULEMANAGEMENT 6.1 Plan Schedule Management 6.1.1 Plan Schedule Management: Inputs 6.1.2 Plan Schedule Management: Tools and Techniques 6.1.3 Plan Schedule Management: Outputs 6.2 Define Activities 6.2.1 Define Activities: Inputs 6.2.2 Define Activities: Tools and Techniques 6.2.3 Define Activities: Outputs 6.3 Sequence Activities 6.3.1 Sequence Activities: Inputs 6.3.2 Sequence Activities: Tools and Techniques 6.3.3 Sequence Activities: Outputs 6.4 Estimate Activity Durations 6.4.1 Estimate Activity Durations: Inputs 6.4.2 Estimate Activity Durations: Tools and Techniques 6.4.3 Estimate Activity Durations: Outputs 6.5 Develop Schedule 6.5.1 Develop Schedule: Inputs 6.5.2 Develop Schedule: Tools and Techniques 6.5.3 Develop Schedule: Outputs 6.6 Control Schedule 6.6.1 Control Schedule: Inputs 6.6.2 Control Schedule: Tools and Techniques 6.6.3 Control Schedule: Outputs 7. PROJECT COST MANAGEMENT 7.1 Plan Cost Management 7.1.1 Plan Cost Management: Inputs
  • 12.
    7.1.2 Plan CostManagement: Tools and Techniques 7.1.3 Plan Cost Management: Outputs 7.2 Estimate Costs 7.2.1 Estimate Costs: Inputs 7.2.2 Estimate Costs: Tools and Techniques 7.2.3 Estimate Costs: Outputs 7.3 Determine Budget 7.3.1 Determine Budget: Inputs 7.3.2 Determine Budget: Tools and Techniques 7.3.3 Determine Budget: Outputs 7.4 Control Costs 7.4.1 Control Costs: Inputs 7.4.2 Control Costs: Tools and Techniques 7.4.3 Control Costs: Outputs 8. PROJECT QUALITY MANAGEMENT 8.1 Plan Quality Management 8.1.1 Plan Quality Management: Inputs 8.1.2 Plan Quality Management: Tools and Techniques 8.1.3 Plan Quality Management: Outputs 8.2 Manage Quality 8.2.1 Manage Quality: Inputs 8.2.2 Manage Quality: Tools and Techniques 8.2.3 Manage Quality: Outputs 8.3 Control Quality 8.3.1 Control Quality: Inputs 8.3.2 Control Quality: Tools and Techniques 8.3.3 Control Quality: Outputs
  • 13.
    9. PROJECT RESOURCEMANAGEMENT 9.1 Plan Resource Management 9.1.1 Plan Resource Management: Inputs 9.1.2 Plan Resource Management: Tools and Techniques 9.1.3 Plan Resource Management: Outputs 9.2 Estimate Activity Resources 9.2.1 Estimate Activity Resources: Inputs 9.2.2 Estimate Activity Resources: Tools and Techniques 9.2.3 Estimate Activity Resources: Outputs 9.3 Acquire Resources 9.3.1 Acquire Resources: Inputs 9.3.2 Acquire Resources: Tools and Techniques 9.3.3 Acquire Resources: Outputs 9.4 Develop Team 9.4.1 Develop Team: Inputs 9.4.2 Develop Team: Tools and Techniques 9.4.3 Develop Team: Outputs 9.5 Manage Team 9.5.1 Manage Team: Inputs 9.5.2 Manage Team: Tools and Techniques 9.5.3 Manage Team: Outputs 9.6 Control Resources 9.6.1 Control Resources: Inputs 9.6.2 Control Resources: Tools and Techniques 9.6.3 Control Resources: Outputs 10. PROJECT COMMUNICATIONS MANAGEMENT 10.1 Plan Communications Management 10.1.1 Plan Communications Management: Inputs
  • 14.
    10.1.2 Plan CommunicationsManagement: Tools and Techniques 10.1.3 Plan Communications Management: Outputs 10.2 Manage Communications 10.2.1 Manage Communications: Inputs 10.2.2 Manage Communications: Tools and Techniques 10.2.3 Manage Communications: Outputs 10.3 Monitor Communications 10.3.1 Monitor Communications: Inputs 10.3.2 Monitor Communications: Tools and Techniques 10.3.3 Monitor Communications: Outputs 11. PROJECT RISK MANAGEMENT 11.1 Plan Risk Management 11.1.1 Plan Risk Management: Inputs 11.1.2 Plan Risk Management: Tools and Techniques 11.1.3 Plan Risk Management: Outputs 11.2 Identify Risks 11.2.1 Identify Risks: Inputs 11.2.2 Identify Risks: Tools and Techniques 11.2.3 Identify Risks: Outputs 11.3 Perform Qualitative Risk Analysis 11.3.1 Perform Qualitative Risk Analysis: Inputs 11.3.2 Perform Qualitative Risk Analysis: Tools and Techniques 11.3.3 Perform Qualitative Risk Analysis: Outputs 11.4 Perform Quantitative Risk Analysis 11.4.1 Perform Quantitative Risk Analysis: Inputs 11.4.2 Perform Quantitative Risk Analysis: Tools and
  • 15.
    Techniques 11.4.3 Perform QuantitativeRisk Analysis: Outputs 11.5 Plan Risk Responses 11.5.1 Plan Risk Responses: Inputs 11.5.2 Plan Risk Responses: Tools and Techniques 11.5.3 Plan Risk Responses: Outputs 11.6 Implement Risk Responses 11.6.1 Implement Risk Responses: Inputs 11.6.2 Implement Risk Responses: Tools and Techniques 11.6.3 Implement Risk Responses: Outputs 11.7 Monitor Risks 11.7.1 Monitor Risks: Inputs 11.7.2 Monitor Risks: Tools and Techniques 11.7.3 Monitor Risks: Outputs 12. PROJECT PROCUREMENT MANAGEMENT 12.1 Plan Procurement Management 12.1.1 Plan Procurement Management: Inputs 12.1.2 Plan Procurement Management: Tools and Techniques 12.1.3 Plan Procurement Management: Outputs 12.2 Conduct Procurements 12.2.1 Conduct Procurements: Inputs 12.2.2 Conduct Procurements: Tools and Techniques 12.2.3 Conduct Procurements: Outputs 12.3 Control Procurements 12.3.1 Control Procurements: Inputs 12.3.2 Control Procurements: Tools and Techniques 12.3.3 Control Procurements: Outputs
  • 16.
    13. PROJECT STAKEHOLDERMANAGEMENT 13.1 Identify Stakeholders 13.1.1 Identify Stakeholders: Inputs 13.1.2 Identify Stakeholders: Tools and Techniques 13.1.3 Identify Stakeholders: Outputs 13.2 Plan Stakeholder Engagement 13.2.1 Plan Stakeholder Engagement: Inputs 13.2.2 Plan Stakeholder Engagement: Tools and Techniques 13.2.3 Plan Stakeholder Engagement: Outputs 13.3 Manage Stakeholder Engagement 13.3.1 Manage Stakeholder Engagement: Inputs 13.3.2 Manage Stakeholder Engagement: Tools and Techniques 13.3.3 Manage Stakeholder Engagement: Outputs 13.4 Monitor Stakeholder Engagement 13.4.1 Monitor Stakeholder Engagement: Inputs 13.4.2 Monitor Stakeholder Engagement: Tools and Techniques 13.4.3 Monitor Stakeholder Engagement: Outputs REFERENCES PART 2. THE STANDARD FOR PROJECT MANAGEMENT 1. INTRODUCTION 1.1 Projects and Project Management 1.2 Relationships Among Portfolios, Programs, and Projects 1.3 Linking Organizational Governance and Project Governance 1.4 Project Success and Benefits Management 1.5 The Project Life Cycle
  • 17.
    1.6 Project Stakeholders 1.7Role of the Project Manager 1.8 Project Management Knowledge Areas 1.9 Project Management Process Groups 1.10 Enterprise Environmental Factors and Organizational Process Assets 1.11 Tailoring the Project Artifacts 2. INITIATING PROCESS GROUP 2.1 Develop Project Charter 2.2 Identify Stakeholders 2.2.1 Project Management Plan Components 2.2.2 Project Documents Examples 2.2.3 Project Management Plan Updates 2.2.4 Project Documents Updates 3. PLANNING PROCESS GROUP 3.1 Develop Project Management Plan 3.2 Plan Scope Management 3.2.1 Project Management Plan Components 3.3 Collect Requirements 3.3.1 Project Management Plan Components 3.3.2 Project Documents Examples 3.4 Define Scope 3.4.1 Project Management Plan Components 3.4.2 Project Documents Examples 3.4.3 Project Documents Updates 3.5 Create WBS 3.5.1 Project Management Plan Components 3.5.2 Project Documents Examples
  • 18.
    3.5.3 Project DocumentsUpdates 3.6 Plan Schedule Management 3.6.1 Project Management Plan Components 3.7 Define Activities 3.7.1 Project Management Plan Components 3.7.2 Project Management Plan Updates 3.8 Sequence Activities 3.8.1 Project Management Plan Components 3.8.2 Project Documents Examples 3.8.3 Project Documents Updates 3.9 Estimate Activity Durations 3.9.1 Project Management Plan Components 3.9.2 Project Documents Examples 3.9.3 Project Documents Updates 3.10 Develop Schedule 3.10.1 Project Management Plan Components 3.10.2 Project Documents Examples 3.10.3 Project Management Plan Updates 3.10.4 Project Documents Updates 3.11 Plan Cost Management 3.11.1 Project Management Plan Components 3.12 Estimate Costs 3.12.1 Project Management Plan Components 3.12.2 Project Documents Examples 3.12.3 Project Documents Updates 3.13 Determine Budget 3.13.1 Project Management Plan Components 3.13.2 Project Documents Examples
  • 19.
    3.13.3 Project DocumentsUpdates 3.14 Plan Quality Management 3.14.1 Project Management Plan Components 3.14.2 Project Documents Examples 3.14.3 Project Management Plan Updates 3.14.4 Project Documents Updates 3.15 Plan Resource Management 3.15.1 Project Management Plan Components 3.15.2 Project Documents 3.15.3 Project Documents Updates 3.16 Estimate Activity Resources 3.16.1 Project Management Plan Components 3.16.2 Project Documents Examples 3.16.3 Project Documents Updates 3.17 Plan Communications Management 3.17.1 Project Management Plan Components 3.17.2 Project Documents Examples 3.17.3 Project Management Plan Updates 3.17.4 Project Documents Updates 3.18 Plan Risk Management 3.18.1 Project Management Plan Components 3.18.2 Project Documents Examples 3.19 Identify Risks 3.19.1 Project Management Plan Components 3.19.2 Project Documents Examples 3.19.3 Project Documents Updates 3.20 Perform Qualitative Risk Analysis 3.20.1 Project Management Plan Components
  • 20.
    3.20.2 Project DocumentsExamples 3.20.3 Project Documents Updates 3.21 Perform Quantitative Risk Analysis 3.21.1 Project Management Plan Components 3.21.2 Project Documents Examples 3.21.3 Project Documents Updates 3.22 Plan Risk Responses 3.22.1 Project Management Plan Components 3.22.2 Project Documents Examples 3.22.3 Project Management Plan Updates 3.22.4 Project Documents Updates 3.23 Plan Procurement Management 3.23.1 Project Management Plan Components 3.23.2 Project Documents Examples 3.23.3 Project Documents Updates 3.24 Plan Stakeholder Engagement 3.24.1 Project Management Plan Components 3.24.2 Project Documents Examples 4. EXECUTING PROCESS GROUP 4.1 Direct and Manage Project Work 4.1.1 Project Management Plan Components 4.1.2 Project Documents Examples 4.1.3 Project Management Plan Updates 4.1.4 Project Documents Updates 4.2 Manage Project Knowledge 4.2.1 Project Management Plan Components 4.2.2 Project Documents 4.2.3 Project Management Plan Updates
  • 21.
    4.3 Manage Quality 4.3.1Project Management Plan Components 4.3.2 Project Documents Examples 4.3.3 Project Management Plan Updates 4.3.4 Project Documents Updates 4.4 Acquire Resources 4.4.1 Project Management Plan Components 4.4.2 Project Documents Examples 4.4.3 Project Management Plan Updates 4.4.4 Project Documents Updates 4.5 Develop Team 4.5.1 Project Management Plan Components 4.5.2 Project Documents Examples 4.5.3 Project Management Plan Updates 4.5.4 Project Documents Updates 4.6 Manage Team 4.6.1 Project Management Plan Components 4.6.2 Project Documents Examples 4.6.3 Project Management Plan Updates 4.6.4 Project Documents Updates 4.7 Manage Communications 4.7.1 Project Management Plan Components 4.7.2 Project Documents Example 4.7.3 Project Management Plan Updates 4.7.4 Project Documents Updates 4.8 Implement Risk Responses 4.8.1 Project Management Plan Components 4.8.2 Project Documents Examples
  • 22.
    4.8.3 Project DocumentsUpdates 4.9 Conduct Procurements 4.9.1 Project Management Plan Components 4.9.2 Project Documents Examples 4.9.3 Project Management Plan Updates 4.9.4 Project Documents Updates 4.10 Manage Stakeholder Engagement 4.10.1 Project Management Plan Components 4.10.2 Project Documents Examples 4.10.3 Project Management Plan Updates 4.10.4 Project Documents Updates 5. MONITORING AND CONTROLLING PROCESS GROUP 5.1 Monitor and Control Project Work 5.1.1 Project Management Plan Components 5.1.2 Project Documents Examples 5.1.3 Project Management Plan Updates 5.1.4 Project Documents Updates 5.2 Perform Integrated Change Control 5.2.1 Project Management Plan Components 5.2.2 Project Documents Examples 5.2.3 Project Management Plan Updates 5.2.4 Project Documents Updates 5.3 Validate Scope 5.3.1 Project Management Plan Components 5.3.2 Project Documents Examples 5.3.3 Project Documents Updates 5.4 Control Scope 5.4.1 Project Management Plan Components
  • 23.
    5.4.2 Project DocumentsExamples 5.4.3 Project Management Plan Updates 5.4.4 Project Documents Updates 5.5 Control Schedule 5.5.1 Project Management Plan Components 5.5.2 Project Documents Examples 5.5.3 Project Management Plan Updates 5.5.4 Project Documents Updates 5.6 Control Costs 5.6.1 Project Management Plan Components 5.6.2 Project Documents Examples 5.6.3 Project Management Plan Updates 5.6.4 Project Documents Updates 5.7 Control Quality 5.7.1 Project Management Plan Components 5.7.2 Project Documents Examples 5.7.3 Project Management Plan Updates 5.7.4 Project Documents Updates 5.8 Control Resources 5.8.1 Project Management Plan Components 5.8.2 Project Documents Examples 5.8.3 Project Management Plan Updates 5.8.4 Project Documents Updates 5.9 Monitor Communications 5.9.1 Project Management Plan Components 5.9.2 Project Documents Examples 5.9.3 Project Management Plan Updates 5.9.4 Project Documents Updates
  • 24.
    5.10 Monitor Risks 5.10.1Project Management Plan Components 5.10.2 Project Documents Examples 5.10.3 Project Management Plan Updates 5.10.4 Project Documents Updates 5.11 Control Procurements 5.11.1 Project Management Plan Components 5.11.2 Project Documents Examples 5.11.3 Project Management Plan Updates 5.11.4 Project Documents Updates 5.12 Monitor Stakeholder Engagement 5.12.1 Project Management Plan Components 5.12.2 Project Documents Examples 5.12.3 Project Management Plan Updates 5.12.4 Project Documents Updates 6. CLOSING PROCESS GROUP 6.1 Close Project or Phase 6.1.1 Project Management Plan Components 6.1.2 Project Documents Examples 6.1.3 Project Documents Updates PART 3. APPENDICES, GLOSSARY, AND INDEX APPENDIX X1 SIXTH EDITION CHANGES APPENDIX X2 CONTRIBUTORS AND REVIEWERS OF THE PMBOK® GUIDE —SIXTH EDITION APPENDIX X3
  • 25.
    AGILE, ITERATIVE, ADAPTIVE,AND HYBRID PROJECT ENVIRONMENTS APPENDIX X4 SUMMARY OF KEY CONCEPTS FOR KNOWLEDGE AREAS APPENDIX X5 SUMMARY OF TAILORING CONSIDERATIONS FOR KNOWLEDGE AREAS APPENDIX X6 TOOLS AND TECHNIQUES GLOSSARY
  • 26.
    LIST OF TABLESAND FIGURES PART 1. A GUIDE TO THE PROJECT MANAGEMENT BODY OF KNOWLEDGE (PMBOK® Guide) Figure 1-1. Organizational State Transition via a Project Figure 1-2. Project Initiation Context Figure 1-3. Portfolio, Programs, Projects, and Operations Figure 1-4. Organizational Project Management Figure 1-5. Interrelationship of PMBOK® Guide Key Components in Projects Figure 1-6. Example Process: Inputs, Tools & Techniques, and Outputs Figure 1-7. Project Data, Information, and Report Flow Figure 1-8. Interrelationship of Needs Assessment and Critical Business/Project Documents Figure 2-1. Project Influences Figure 3-1. Example of Project Manager's Sphere of Influence Figure 3-2. The PMI Talent Triangle® Figure 4-1. Project Integration Management Overview Figure 4-2. Develop Project Charter: Inputs, Tools & Techniques, and Outputs Figure 4-3. Develop Project Charter: Data Flow Diagram Figure 4-4. Develop Project Management Plan: Inputs, Tools & Techniques, and Outputs Figure 4-5. Develop Project Management Plan: Data Flow Diagram
  • 27.
    Figure 4-6. Directand Manage Project Work: Inputs, Tools & Techniques, and Outputs Figure 4-7. Direct and Manage Project Work: Data Flow Diagram Figure 4-8. Manage Project Knowledge: Inputs, Tools & Techniques, and Outputs Figure 4-9. Manage Project Knowledge: Data Flow Diagram Figure 4-10. Monitor and Control Project Work: Inputs, Tools & Techniques, and Outputs Figure 4-11. Monitor and Control Project Work: Data Flow Diagram Figure 4-12. Perform Integrated Change Control: Inputs, Tools & Techniques, and Outputs Figure 4-13. Perform Integrated Change Control: Data Flow Diagram Figure 4-14. Close Project or Phase: Inputs, Tools & Techniques, and Outputs Figure 4-15. Close Project or Phase: Data Flow Diagram Figure 5-1. Project Scope Management Overview Figure 5-2. Plan Scope Management: Inputs, Tools & Techniques, and Outputs Figure 5-3. Plan Scope Management: Data Flow Diagram Figure 5-4. Collect Requirements: Inputs, Tools & Techniques, and Outputs Figure 5-5. Collect Requirements: Data Flow Diagram Figure 5-6. Context Diagram Figure 5-7. Example of a Requirements Traceability Matrix Figure 5-8. Define Scope: Inputs, Tools & Techniques, and Outputs Figure 5-9. Define Scope: Data Flow Diagram
  • 28.
    Figure 5-10. CreateWBS: Inputs, Tools & Techniques, and Outputs Figure 5-11. Create WBS: Data Flow Diagram Figure 5-12. Sample WBS Decomposed Down Through Work Packages Figure 5-13. Sample WBS Organized by Phase Figure 5-14. Sample WBS with Major Deliverables Figure 5-15. Validate Scope: Inputs, Tools & Techniques, and Outputs Figure 5-16. Validate Scope: Data Flow Diagram Figure 5-17. Control Scope: Inputs, Tools & Techniques, and Outputs Figure 5-18. Control Scope: Data Flow Diagram Figure 6-1. Project Schedule Management Overview Figure 6-2. Scheduling Overview Figure 6-3. Plan Schedule Management: Inputs, Tools & Techniques, and Outputs Figure 6-4. Plan Schedule Management: Data Flow Diagram Figure 6-5. Define Activities: Inputs, Tools & Techniques, and Outputs Figure 6-6. Define Activities: Data Flow Diagram Figure 6-7. Sequence Activities: Inputs, Tools & Techniques, and Outputs Figure 6-8. Sequence Activities: Data Flow Diagram Figure 6-9. Precedence Diagramming Method (PDM) Relationship Types Figure 6-10. Examples of Lead and Lag Figure 6-11. Project Schedule Network Diagram Figure 6-12. Estimate Activity Durations: Inputs, Tools & Techniques, and Outputs
  • 29.
    Figure 6-13. EstimateActivity Durations: Data Flow Diagram Figure 6-14. Develop Schedule: Inputs, Tools & Techniques, and Outputs Figure 6-15. Develop Schedule: Data Flow Diagram Figure 6-16. Example of Critical Path Method Figure 6-17. Resource Leveling Figure 6-18. Example Probability Distribution of a Target Milestone Figure 6-19. Schedule Compression Comparison Figure 6-20. Relationship Between Product Vision, Release Planning, and Iteration Planning Figure 6-21. Project Schedule Presentations—Examples Figure 6-22. Control Schedule: Inputs, Tools & Techniques, and Outputs Figure 6-23. Control Schedule: Data Flow Diagram Figure 6-24. Iteration Burndown Chart Figure 7-1. Project Cost Management Overview Figure 7-2. Plan Cost Management: Inputs, Tools & Techniques, and Outputs Figure 7-3. Plan Cost Management: Data Flow Diagram Figure 7-4. Estimate Costs: Inputs, Tools & Techniques, and Outputs Figure 7-5. Estimate Costs: Data Flow Diagram Figure 7-6. Determine Budget: Inputs, Tools & Techniques, and Outputs Figure 7-7. Determine Budget: Data Flow Diagram Figure 7-8. Project Budget Components Figure 7-9. Cost Baseline, Expenditures, and Funding Requirements Figure 7-10. Control Costs: Inputs, Tools & Techniques, and Outputs
  • 30.
    Figure 7-11. ControlCosts: Data Flow Diagram Figure 7-12. Earned Value, Planned Value, and Actual Costs Figure 7-13. To-Complete Performance Index (TCPI) Figure 8-1. Project Quality Management Overview Figure 8-2. Major Project Quality Management Process Interrelations Figure 8-3. Plan Quality Management: Inputs, Tools & Techniques, and Outputs Figure 8-4. Plan Quality Management: Data Flow Diagram Figure 8-5. Cost of Quality Figure 8-6. The SIPOC Model Figure 8-7. Manage Quality: Inputs, Tools & Techniques, and Outputs Figure 8-8. Manage Quality: Data Flow Diagram Figure 8-9. Cause-and-Effect Diagram Figure 8-10. Control Quality: Inputs, Tools & Techniques, and Outputs Figure 8-11. Control Quality: Data Flow Diagram Figure 8-12. Check Sheets Figure 9-1. Project Resource Management Overview Figure 9-2. Plan Resource Management: Inputs, Tools & Techniques, and Outputs Figure 9-3. Plan Resource Management: Data Flow Diagram Figure 9-4. Sample RACI Chart Figure 9-5. Estimate Activity Resources: Inputs, Tools & Techniques, and Outputs Figure 9-6. Estimate Activity Resources: Data Flow Diagram Figure 9-7. Sample Resource Breakdown Structure Figure 9-8. Acquire Resources: Inputs, Tools & Techniques, and
  • 31.
    Outputs Figure 9-9. AcquireResources: Data Flow Diagram Figure 9-10. Develop Team: Inputs, Tools & Techniques, and Outputs Figure 9-11. Develop Team: Data Flow Diagram Figure 9-12. Manage Team: Inputs, Tools & Techniques, and Outputs Figure 9-13. Manage Team: Data Flow Diagram Figure 9-14. Control Resources: Inputs, Tools & Techniques, and Outputs Figure 9-15. Control Resources: Data Flow Diagram Figure 10-1. Project Communications Overview Figure 10-2. Plan Communications Management: Inputs, Tools & Techniques, and Outputs Figure 10-3. Plan Communications Management: Data Flow Diagram Figure 10-4. Communication Model for Cross-Cultural Communication Figure 10-5. Manage Communications: Inputs, Tools & Techniques, and Outputs Figure 10-6. Manage Communications: Data Flow Diagram Figure 10-7. Monitor Communications: Inputs, Tools & Techniques, and Outputs Figure 10-8. Monitor Communications: Data Flow Diagram Figure 11-1. Project Risk Management Overview Figure 11-2. Plan Risk Management: Inputs, Tools & Techniques, and Outputs Figure 11-3. Plan Risk Management: Data Flow Diagram Figure 11-4. Extract from Sample Risk Breakdown Structure (RBS) Figure 11-5. Example Probability and Impact Matrix with Scoring
  • 32.
    Scheme Figure 11-6. IdentifyRisks: Inputs, Tools & Techniques, and Outputs Figure 11-7. Identify Risks: Data Flow Diagram Figure 11-8. Perform Qualitative Risk Analysis: Inputs, Tools & Techniques, and Outputs Figure 11-9. Perform Qualitative Risk Analysis: Data Flow Diagram Figure 11-10. Example Bubble Chart Showing Detectability, Proximity, and Impact Value Figure 11-11. Perform Quantitative Risk Analysis: Inputs, Tools & Techniques, and Outputs Figure 11-12. Perform Quantitative Risk Analysis: Data Flow Diagram Figure 11-13. Example S-Curve from Quantitative Cost Risk Analysis Figure 11-14. Example Tornado Diagram Figure 11-15. Example Decision Tree Figure 11-16. Plan Risk Responses: Inputs, Tools & Techniques, and Outputs Figure 11-17. Plan Risk Responses: Data Flow Diagram Figure 11-18. Implement Risk Responses: Inputs, Tools & Techniques, and Outputs Figure 11-19. Implement Risk Responses: Data Flow Diagram Figure 11-20. Monitor Risks: Inputs, Tools & Techniques, and Outputs Figure 11-21. Monitor Risks: Data Flow Diagram Figure 12-1. Project Procurement Management Overview Figure 12-2. Plan Procurement Management: Inputs, Tools & Techniques, and Outputs
  • 33.
    Figure 12-3. PlanProcurement Management: Data Flow Diagram Figure 12-4. Conduct Procurements: Inputs, Tools & Techniques, and Outputs Figure 12-5. Conduct Procurements: Data Flow Diagram Figure 12-6. Control Procurements: Inputs, Tools & Techniques, and Outputs Figure 12-7. Control Procurements: Data Flow Diagram Figure 13-1. Project Stakeholder Management Overview Figure 13-2. Identify Stakeholders: Inputs, Tools & Techniques, and Outputs Figure 13-3. Identify Stakeholders: Data Flow Diagram Figure 13-4. Plan Stakeholder Engagement: Inputs, Tools & Techniques, and Outputs Figure 13-5. Plan Stakeholder Engagement: Data Flow Diagram Figure 13-6. Stakeholder Engagement Assessment Matrix Figure 13-7. Manage Stakeholder Engagement: Inputs, Tools & Techniques, and Outputs Figure 13-8. Manage Stakeholder Engagement: Data Flow Diagram Figure 13-9. Monitor Stakeholder Engagement: Inputs, Tools & Techniques, and Outputs Figure 13-10. Monitor Stakeholder Engagement: Data Flow Diagram Table 1-1. Examples of Factors that Lead to the Creation of a Project Table 1-2. Comparative Overview of Portfolios, Programs, and Projects Table 1-3. Description of PMBOK® Guide Key Components Table 1-4. Project Management Process Group and Knowledge Area Mapping Table 1-5. Project Business Documents
  • 34.
    Table 2-1. Influencesof Organizational Structures on Projects Table 3-1. Team Management and Team Leadership Compared Table 4-1. Project Management Plan and Project Documents Table 5-1. Elements of the Project Charter and Project Scope Statement Table 7-1. Earned Value Calculations Summary Table Table 11-1. Example of Definitions for Probability and Impacts Table 12-1. Comparison of Procurement Documentation PART 2. The Standard For Project Management Figure 1-1. Example of Portfolio, Program, and Project Management Interfaces Figure 1-2. Generic Depiction of a Project Life Cycle Figure 1-3. Impact of Variables Over Time Figure 1-4. Examples of Project Stakeholders Figure 1-5. Example of Process Group Interactions Within a Project or Phase Figure 2-1. Project Boundaries Figure 2-2. Initiating Process Group Figure 2-3. Develop Project Charter: Inputs and Outputs Figure 2-4. Identify Stakeholders: Inputs and Outputs Figure 3-1. Planning Process Group Figure 3-2. Develop Project Management Plan: Inputs and Outputs Figure 3-3. Plan Scope Management: Inputs and Outputs Figure 3-4. Collect Requirements: Inputs and Outputs Figure 3-5. Define Scope: Inputs and Outputs Figure 3-6. Create WBS: Inputs and Outputs Figure 3-7. Plan Schedule Management: Inputs and Outputs
  • 35.
    Figure 3-8. DefineActivities: Inputs and Outputs Figure 3-9. Sequence Activities: Inputs and Outputs Figure 3-10. Estimate Activity Durations: Inputs and Outputs Figure 3-11. Develop Schedule: Inputs and Outputs Figure 3-12. Plan Cost Management: Inputs and Outputs Figure 3-13. Estimate Costs: Inputs and Outputs Figure 3-14. Determine Budget: Inputs and Outputs Figure 3-15. Plan Quality Management: Inputs and Outputs Figure 3-16. Plan Resource Management: Inputs and Outputs Figure 3-17. Estimate Activity Resources: Inputs and Outputs Figure 3-18. Plan Communications Management: Inputs and Outputs Figure 3-19. Plan Risk Management: Inputs and Outputs Figure 3-20. Identify Risks: Inputs and Outputs Figure 3-21. Perform Qualitative Risk Analysis: Inputs and Outputs Figure 3-22. Perform Quantitative Risk Analysis: Inputs and Outputs Figure 3-23. Plan Risk Responses: Inputs and Outputs Figure 3-24. Plan Procurement Management: Inputs and Outputs Figure 3-25. Plan Stakeholder Engagement: Inputs and Outputs Figure 4-1. Executing Process Group Figure 4-2. Direct and Manage Project Work: Inputs and Outputs Figure 4-3. Manage Project Knowledge: Inputs and Outputs Figure 4-4. Manage Quality: Inputs and Outputs Figure 4-5. Acquire Resources: Inputs and Outputs Figure 4-6. Develop Team: Inputs and Outputs Figure 4-7. Manage Team: Inputs and Outputs Figure 4-8. Manage Communications: Inputs and Outputs Figure 4-9. Implement Risk Responses: Inputs and Outputs
  • 36.
    Figure 4-10. ConductProcurements: Inputs and Outputs Figure 4-11. Manage Stakeholder Engagement: Inputs and Outputs Figure 5-1. Monitoring and Controlling Process Group Figure 5-2. Monitor and Control Project Work: Inputs and Outputs Figure 5-3. Perform Integrated Change Control: Inputs and Outputs Figure 5-4. Validate Scope: Inputs and Outputs Figure 5-5. Control Scope: Inputs and Outputs Figure 5-6. Control Schedule: Inputs and Outputs Figure 5-7. Control Costs: Inputs and Outputs Figure 5-8. Control Quality: Inputs and Outputs Figure 5-9. Control Resources: Inputs and Outputs Figure 5-10. Monitor Communications: Inputs and Outputs Figure 5-11. Monitor Risks: Inputs and Outputs Figure 5-12. Control Procurements: Inputs and Outputs Figure 5-13. Monitor Stakeholder Engagement: Inputs and Outputs Figure 6-1. Closing Process Group Figure 6-2. Close Project or Phase: Inputs and Outputs Table 1-1. Project Management Process Group and Knowledge Area Mapping Table 1-2. Project Management Plan and Project Documents PART 3. APPENDICES, GLOSSARY, AND INDEX Figure X3-1. The Continuum of Project Life Cycles Figure X3-2. Level of Effort for Process Groups across Iteration Cycles
  • 37.
    Figure X3-3. Relationshipof Process Groups in Continuous Phases Table X1-1. Section 4 Changes Table X1-2. Section 6 Changes Table X1-3. Section 8 Changes Table X1-4. Section 9 Changes Table X1-5. Section 10 Changes Table X1-6. Section 11 Changes Table X1-7. Section 12 Changes Table X1-8. Section 13 Changes Table X6-1. Categorization and Index of Tools and Techniques
  • 38.
    Part 1 A Guideto the Project Management Body of Knowledge (PMBOK® GUIDE) The information contained in this part is not an American National Standard (ANS) and has not been processed in accordance with ANSI's requirements for an ANS. As such, the information in this part may contain material that has not been subjected to public review or a consensus process. In addition, it does not contain requirements necessary for conformance to an ANS standard.
  • 39.
    1 INTRODUCTION 1.1 OVERVIEW ANDPURPOSE OF THIS GUIDE Project management is not new. It has been in use for hundreds of years. Examples of project outcomes include: Pyramids of Giza, Olympic games, Great Wall of China, Taj Mahal, Publication of a children's book, Panama Canal, Development of commercial jet airplanes, Polio vaccine, Human beings landing on the moon, Commercial software applications, Portable devices to use the global positioning system (GPS), and Placement of the International Space Station into Earth's orbit. The outcomes of these projects were the result of leaders and managers applying project management practices, principles, processes, tools, and techniques to their work. The managers of these projects used a set of key skills and applied knowledge to satisfy their customers and other people involved in and affected by the project. By the mid-20th century, project managers began the work of seeking recognition for project management as a profession. One aspect of this work involved obtaining agreement on the content of the body of knowledge (BOK) called project management. This BOK became known as the
  • 40.
    Project Management Bodyof Knowledge (PMBOK). The Project Management Institute (PMI) produced a baseline of charts and glossaries for the PMBOK. Project managers soon realized that no single book could contain the entire PMBOK. Therefore, PMI developed and published A Guide to the Project Management Body of Knowledge (PMBOK® Guide). PMI defines the project management body of knowledge (PMBOK) as a term that describes the knowledge within the profession of project management. The project management body of knowledge includes proven traditional practices that are widely applied as well as innovative practices that are emerging in the profession. The body of knowledge (BOK) includes both published and unpublished materials. This body of knowledge is constantly evolving. This PMBOK® Guide identifies a subset of the project management body of knowledge that is generally recognized as good practice. Generally recognized means the knowledge and practices described are applicable to most projects most of the time, and there is consensus about their value and usefulness. Good practice means there is general agreement that the application of the knowledge, skills, tools, and techniques to project management processes can enhance the chance of success over many projects in delivering the expected business values and results. The project manager works with the project team and other stakeholders to determine and use the appropriate generally recognized good practices for each project. Determining the appropriate combination of processes, inputs, tools, techniques, outputs and life cycle phases to manage a project is referred to as “tailoring” the application of the knowledge described in this guide. This PMBOK® Guide is different from a methodology. A methodology is a system of practices, techniques, procedures, and rules used by those who work in a discipline. This PMBOK® Guide is a foundation upon which organizations can build methodologies, policies, procedures, rules, tools and techniques, and life cycle phases needed to practice project management. 1.1.1 THE STANDARD FOR PROJECT MANAGEMENT This guide is based on The Standard for Project Management [1]. A standard is a document established by an authority, custom, or general consent as a model
  • 41.
    or example. Asan American National Standards Institute (ANSI) standard, The Standard for Project Management was developed using a process based on the concepts of consensus, openness, due process, and balance. The Standard for Project Management is a foundational reference for PMI's project management professional development programs and the practice of project management. Because project management needs to be tailored to fit the needs of the project, the standard and the guide are both based on descriptive practices, rather than prescriptive practices. Therefore, the standard identifies the processes that are considered good practices on most projects, most of the time. The standard also identifies the inputs and outputs that are usually associated with those processes. The standard does not require that any particular process or practice be performed. The Standard for Project Management is included as Part II of A Guide to the Project Management Body of Knowledge (PMBOK® Guide). The PMBOK® Guide provides more detail about key concepts, emerging trends, considerations for tailoring the project management processes, and information on how tools and techniques are applied to projects. Project managers may use one or more methodologies to implement the project management processes outlined in the standard. The scope of this guide is limited to the discipline of project management, rather than the full spectrum of portfolios, programs, and projects. Portfolios and programs will be addressed only to the degree they interact with projects. PMI publishes two other standards that address the management of portfolios and programs: The Standard for Portfolio Management [2], and The Standard for Program Management [3]. 1.1.2 COMMON VOCABULARY A common vocabulary is an essential element of a professional discipline. The PMI Lexicon of Project Management Terms [4] provides the foundational professional vocabulary that can be consistently used by organizations, portfolio, program, and project managers and other project stakeholders. The Lexicon will continue to evolve over time. The glossary to this guide includes the vocabulary in the Lexicon along with additional definitions. There may be other industry- specific terms used in projects that are defined by that industry's literature.
  • 42.
    1.1.3 CODE OFETHICS AND PROFESSIONAL CONDUCT PMI publishes the Code of Ethics and Professional Conduct [5] to instill confidence in the project management profession and to help an individual in making wise decisions, particularly when faced with difficult situations where the individual may be asked to compromise his or her integrity or values. The values that the global project management community defined as most important were responsibility, respect, fairness, and honesty. The Code of Ethics and Professional Conduct affirms these four values as its foundation. The Code of Ethics and Professional Conduct includes both aspirational standards and mandatory standards. The aspirational standards describe the conduct that practitioners, who are also PMI members, certification holders, or volunteers, strive to uphold. Although adherence to the aspirational standards is not easily measured, conduct in accordance with these is an expectation for those who consider themselves to be professionals—it is not optional. The mandatory standards establish firm requirements and, in some cases, limit or prohibit practitioner behavior. Practitioners who are also PMI members, certification holders, or volunteers and who do not conduct themselves in accordance with these standards will be subject to disciplinary procedures before PMI's Ethics Review Committee. 1.2 FOUNDATIONAL ELEMENTS This section describes foundational elements necessary for working in and understanding the discipline of project management. 1.2.1 PROJECTS A project is a temporary endeavor undertaken to create a unique product, service, or result. Unique product, service, or result. Projects are undertaken to fulfill objectives by producing deliverables. An objective is defined as an outcome toward which work is to be directed, a strategic position to be attained, a purpose to be achieved, a result to be obtained, a product to be produced, or a service to be performed. A deliverable is defined as any unique and verifiable product, result, or capability to perform a service that is required to be produced to complete a process, phase, or
  • 43.
    project. Deliverables maybe tangible or intangible. Fulfillment of project objectives may produce one or more of the following deliverables: A unique product that can be either a component of another item, an enhancement or correction to an item, or a new end item in itself (e.g., the correction of a defect in an end item); A unique service or a capability to perform a service (e.g., a business function that supports production or distribution); A unique result, such as an outcome or document (e.g., a research project that develops knowledge that can be used to determine whether a trend exists or a new process will benefit society); and A unique combination of one or more products, services, or results (e.g., a software application, its associated documentation, and help desk services). Repetitive elements may be present in some project deliverables and activities. This repetition does not change the fundamental and unique characteristics of the project work. For example, office buildings can be constructed with the same or similar materials and by the same or different teams. However, each building project remains unique in key characteristics (e.g., location, design, environment, situation, people involved). Projects are undertaken at all organizational levels. A project can involve a single individual or a group. A project can involve a single organizational unit or multiple organizational units from multiple organizations. Examples of projects include but are not limited to: Developing a new pharmaceutical compound for market, Expanding a tour guide service, Merging two organizations, Improving a business process within an organization, Acquiring and installing a new computer hardware system for use in an organization, Exploring for oil in a region, Modifying a computer software program used in an organization,
  • 44.
    Conducting research todevelop a new manufacturing process, and Constructing a building. Temporary endeavor. The temporary nature of projects indicates that a project has a definite beginning and end. Temporary does not necessarily mean a project has a short duration. The end of the project is reached when one or more of the following is true: The project's objectives have been achieved; The objectives will not or cannot be met; Funding is exhausted or no longer available for allocation to the project; The need for the project no longer exists (e.g., the customer no longer wants the project completed, a change in strategy or priority ends the project, the organizational management provides direction to end the project); The human or physical resources are no longer available; or The project is terminated for legal cause or convenience. Projects are temporary, but their deliverables may exist beyond the end of the project. Projects may produce deliverables of a social, economic, material, or environmental nature. For example, a project to build a national monument will create a deliverable expected to last for centuries. Projects drive change. Projects drive change in organizations. From a business perspective, a project is aimed at moving an organization from one state to another state in order to achieve a specific objective (see Figure 1-1). Before the project begins, the organization is commonly referred to as being in the current state. The desired result of the change driven by the project is described as the future state. For some projects, this may involve creating a transition state where multiple steps are made along a continuum to achieve the future state. The successful completion of a project results in the organization moving to the future state and achieving the specific objective. For more information on project management and change, see Managing Change in Organizations: A Practice Guide [6].
  • 45.
    Projects enable businessvalue creation. PMI defines business value as the net quantifiable benefit derived from a business endeavor. The benefit may be tangible, intangible, or both. In business analysis, business value is considered the return, in the form of elements such as time, money, goods, or intangibles in return for something exchanged (see Business Analysis for Practitioners: A Practice Guide, p. 185 [7]). Business value in projects refers to the benefit that the results of a specific project provide to its stakeholders. The benefit from projects may be tangible, intangible, or both. Examples of tangible elements include: Monetary assets, Stockholder equity, Utility, Fixtures, Tools, and Market share. Examples of intangible elements include: Goodwill,
  • 46.
    Brand recognition, Public benefit, Trademarks, Strategicalignment, and Reputation. Project Initiation Context. Organizational leaders initiate projects in response to factors acting upon their organizations. There are four fundamental categories for these factors, which illustrate the context of a project (see Figure 1-2): Meet regulatory, legal, or social requirements; Satisfy stakeholder requests or needs; Implement or change business or technological strategies; and Create, improve, or fix products, processes, or services. These factors influence an organization's ongoing operations and business strategies. Leaders respond to these factors in order to keep the organization viable. Projects provide the means for organizations to successfully make the changes necessary to deal with these factors. These factors ultimately should link to the strategic objectives of the organization and the business value of each
  • 47.
    project. 1.2.2 THE IMPORTANCEOF PROJECT MANAGEMENT Project management is the application of knowledge, skills, tools, and techniques to project activities to meet the project requirements. Project management is accomplished through the appropriate application and integration of the project management processes identified for the project. Project management enables organizations to execute projects effectively and efficiently. Effective project management helps individuals, groups, and public and private organizations to:
  • 48.
    Meet business objectives; Satisfystakeholder expectations; Be more predictable; Increase chances of success; Deliver the right products at the right time; Resolve problems and issues; Respond to risks in a timely manner; Optimize the use of organizational resources; Identify, recover, or terminate failing projects; Manage constraints (e.g., scope, quality, schedule, costs, resources); Balance the influence of constraints on the project (e.g., increased scope may increase cost or schedule); and Manage change in a better manner. Poorly managed projects or the absence of project management may result in: Missed deadlines, Cost overruns, Poor quality, Rework, Uncontrolled expansion of the project, Loss of reputation for the organization, Unsatisfied stakeholders, and Failure in achieving the objectives for which the project was undertaken. Projects are a key way to create value and benefits in organizations. In today's business environment, organizational leaders need to be able to manage with tighter budgets, shorter timelines, scarcity of resources, and rapidly changing technology. The business environment is dynamic with an accelerating rate of change. To remain competitive in the world economy, companies are embracing project management to consistently deliver business value. Effective and efficient project management should be considered a strategic
  • 49.
    competency within organizations.It enables organizations to: Tie project results to business goals, Compete more effectively in their markets, Sustain the organization, and Respond to the impact of business environment changes on projects by appropriately adjusting project management plans (see Section 4.2). 1.2.3 RELATIONSHIP OF PROJECT, PROGRAM, PORTFOLIO, AND OPERATIONS MANAGEMENT 1.2.3.1 OVERVIEW Using project management processes, tools, and techniques puts in place a sound foundation for organizations to achieve their goals and objectives. A project may be managed in three separate scenarios: as a stand-alone project (outside of a portfolio or program), within a program, or within a portfolio. Project managers interact with portfolio and program managers when a project is within a program or portfolio. For example, multiple projects may be needed to accomplish a set of goals and objectives for an organization. In those situations, projects may be grouped together into a program. A program is defined as a group of related projects, subsidiary programs, and program activities managed in a coordinated manner to obtain benefits not available from managing them individually. Programs are not large projects. A very large project may be referred to as a megaproject. As a guideline, megaprojects cost US$1billion or more, affect 1 million or more people, and run for years. Some organizations may employ the use of a project portfolio to effectively manage multiple programs and projects that are underway at any given time. A portfolio is defined as projects, programs, subsidiary portfolios, and operations managed as a group to achieve strategic objectives. Figure 1-3 illustrates an example of how portfolios, programs, projects, and operations are related in a specific situation. Program management and portfolio management differ from project management in their life cycles, activities, objectives, focus, and benefits. However, portfolios, programs, projects, and operations often engage with the same stakeholders and may need to use the same resources (see Figure 1-3), which may result in a conflict in the organization. This type of a situation
  • 50.
    increases the needfor coordination within the organization through the use of portfolio, program, and project management to achieve a workable balance in the organization. Figure 1-3 illustrates a sample portfolio structure indicating relationships between the programs, projects, shared resources, and stakeholders. The portfolio components are grouped together in order to facilitate the effective governance and management of the work that helps to achieve organizational strategies and priorities. Organizational and portfolio planning impact the components by means of prioritization based on risk, funding, and other considerations. The portfolio view allows organizations to see how the strategic goals are reflected in the portfolio. This portfolio view also enables the implementation and coordination of appropriate portfolio, program, and project governance. This coordinated governance allows authorized allocation of human, financial, and physical resources based on expected performance and benefits. Looking at project, program, and portfolio management from an organizational perspective: Program and project management focus on doing programs and projects the “right” way; and
  • 51.
    Portfolio management focuseson doing the “right” programs and projects. Table 1-2 gives a comparative overview of portfolios, programs, and projects. 1.2.3.2 PROGRAM MANAGEMENT Program management is defined as the application of knowledge, skills, and principles to a program to achieve the program objectives and to obtain benefits and control not available by managing program components individually. A program component refers to projects and other programs within a program. Project management focuses on interdependencies within a project to determine the optimal approach for managing the project. Program management focuses on the interdependencies between projects and between projects and the program level to determine the optimal approach for managing them. Actions related to these program and project-level interdependencies may include:
  • 52.
    Aligning with theorganizational or strategic direction that affects program and project goals and objectives; Allocating the program scope into program components; Managing interdependencies among the components of the program to best serve the program; Managing program risks that may impact multiple projects in the program; Resolving constraints and conflicts that affect multiple projects within the program; Resolving issues between component projects and the program level; Managing change requests within a shared governance framework; Allocating budgets across multiple projects within the program; and Assuring benefits realization from the program and component projects. An example of a program is a new communications satellite system with projects for the design and construction of the satellite and the ground stations, the launch of the satellite, and the integration of the system. For more information on program management, see The Standard for Program Management [3]. 1.2.3.3 PORTFOLIO MANAGEMENT A portfolio is defined as projects, programs, subsidiary portfolios, and operations managed as a group to achieve strategic objectives. Portfolio management is defined as the centralized management of one or more portfolios to achieve strategic objectives. The programs or projects of the portfolio may not necessarily be interdependent or directly related. The aim of portfolio management is to: Guide organizational investment decisions. Select the optimal mix of programs and projects to meet strategic objectives. Provide decision-making transparency. Prioritize team and physical resource allocation. Increase the likelihood of realizing the desired return on investment.
  • 53.
    Centralize the managementof the aggregate risk profile of all components. Portfolio management also confirms that the portfolio is consistent with and aligned with organizational strategies. Maximizing the value of the portfolio requires careful examination of the components that comprise the portfolio. Components are prioritized so that those contributing the most to the organization's strategic objectives have the required financial, team, and physical resources. For example, an infrastructure organization that has the strategic objective of maximizing the return on its investments may put together a portfolio that includes a mix of projects in oil and gas, power, water, roads, rail, and airports. From this mix, the organization may choose to manage related projects as one portfolio. All of the power projects may be grouped together as a power portfolio. Similarly, all of the water projects may be grouped together as a water portfolio. However, when the organization has projects in designing and constructing a power plant and then operates the power plant to generate energy, those related projects can be grouped in one program. Thus, the power program and similar water program become integral components of the portfolio of the infrastructure organization. For more information on portfolio management, see The Standard for Portfolio Management [2]. 1.2.3.4 OPERATIONS MANAGEMENT Operations management is an area that is outside the scope of formal project management as described in this guide. Operations management is concerned with the ongoing production of goods and/or services. It ensures that business operations continue efficiently by using the optimal resources needed to meet customer demands. It is concerned with managing processes that transform inputs (e.g., materials, components, energy, and labor) into outputs (e.g., products, goods, and/or services). 1.2.3.5 OPERATIONS AND PROJECT MANAGEMENT Changes in business or organizational operations may be the focus of a project —especially when there are substantial changes to business operations as a result of a new product or service delivery. Ongoing operations are outside of the scope of a project; however, there are intersecting points where the two areas
  • 54.
    cross. Projects can intersectwith operations at various points during the product life cycle, such as; When developing a new product, upgrading a product, or expanding outputs; While improving operations or the product development process; At the end of the product life cycle; and At each closeout phase. At each point, deliverables and knowledge are transferred between the project and operations for implementation of the delivered work. This implementation occurs through a transfer of project resources or knowledge to operations or through a transfer of operational resources to the project. 1.2.3.6 ORGANIZATIONAL PROJECT MANAGEMENT (OPM) AND STRATEGIES Portfolios, programs, and projects are aligned with or driven by organizational strategies and differ in the way each contributes to the achievement of strategic goals: Portfolio management aligns portfolios with organizational strategies by selecting the right programs or projects, prioritizing the work, and providing the needed resources. Program management harmonizes its program components and controls interdependencies in order to realize specified benefits. Project management enables the achievement of organizational goals and objectives. Within portfolios or programs, projects are a means of achieving organizational goals and objectives. This is often accomplished in the context of a strategic plan that is the primary factor guiding investments in projects. Alignment with the organization's strategic business goals can be achieved through the systematic management of portfolios, programs, and projects through the application of organizational project management (OPM). OPM is defined as a framework in which portfolio, program, and project management are integrated with organizational enablers in order to achieve strategic objectives.
  • 55.
    The purpose ofOPM is to ensure that the organization undertakes the right projects and allocates critical resources appropriately. OPM also helps to ensure that all levels in the organization understand the strategic vision, the initiatives that support the vision, the objectives, and the deliverables. Figure 1-4 shows the organizational environment where strategy, portfolio, programs, projects, and operations interact. For more information on OPM, refer to Implementing Organizational Project Management: A Practice Guide [8]. 1.2.4 COMPONENTS OF THE GUIDE Projects comprise several key components that, when effectively managed, result in their successful completion. This guide identifies and explains these components. The various components interrelate to one another during the management of a project. The key components are described briefly in Table 1-3. These components are more fully explained in the sections that follow the table. Table 1-3. Description of PMBOK® Guide Key Components PMBOK® Guide Key Component Brief Description
  • 56.
    Project life cycle(Section 1.2.4.1) The series of phases that a project passes through from its start to its completion. Project phase (Section 1.2.4.2) A collection of logically related project activities that culminates in the completion of one or more deliverables. Phase gate (Section 1.2.4.3) A review at the end of a phase in which a decision is made to continue to the next phase, to continue with modification, or to end a program or project. Project management processes (Section 1.2.4.4) A systematic series of activities directed toward causing an end result where one or more inputs will be acted upon to create one or more outputs. Project Management Process Group (Section 1.2.4.5) A logical grouping of project management inputs, tools and techniques, and outputs. The Project Management Process Groups include Initiating, Planning, Executing, Monitoring and Controlling, and Closing. Project Management Process Groups are not project phases. Project Management Knowledge Area (Section 1.2.4.6) An identified area of project management defined by its knowledge requirements and described in terms of its component processes, practices, inputs, outputs, tools, and techniques.
  • 57.
    1.2.4.1 PROJECT ANDDEVELOPMENT LIFE CYCLES A project life cycle is the series of phases that a project passes through from its start to its completion. It provides the basic framework for managing the project. This basic framework applies regardless of the specific project work involved. The phases may be sequential, iterative, or overlapping. All projects can be mapped to the generic life cycle shown in Figure 1-5. Project life cycles can be predictive or adaptive. Within a project life cycle, there are generally one or more phases that are associated with the development of the product, service, or result. These are called a development life cycle. Development life cycles can be predictive, iterative, incremental, adaptive, or a hybrid model: In a predictive life cycle, the project scope, time, and cost are determined in the early phases of the life cycle. Any changes to the
  • 58.
    scope are carefullymanaged. Predictive life cycles may also be referred to as waterfall life cycles. In an iterative life cycle, the project scope is generally determined early in the project life cycle, but time and cost estimates are routinely modified as the project team's understanding of the product increases. Iterations develop the product through a series of repeated cycles, while increments successively add to the functionality of the product. In an incremental life cycle, the deliverable is produced through a series of iterations that successively add functionality within a predetermined time frame. The deliverable contains the necessary and sufficient capability to be considered complete only after the final iteration. Adaptive life cycles are agile, iterative, or incremental. The detailed scope is defined and approved before the start of an iteration. Adaptive life cycles are also referred to as agile or change-driven life cycles. See Appendix X3. A hybrid life cycle is a combination of a predictive and an adaptive life cycle. Those elements of the project that are well known or have fixed requirements follow a predictive development life cycle, and those elements that are still evolving follow an adaptive development life cycle. It is up to the project management team to determine the best life cycle for each project. The project life cycle needs to be flexible enough to deal with the variety of factors included in the project. Life cycle flexibility may be accomplished by: Identifying the process or processes needed to be performed in each phase, Performing the process or processes identified in the appropriate phase, Adjusting the various attributes of a phase (e.g., name, duration, exit criteria, and entrance criteria). Project life cycles are independent of product life cycles, which may be produced by a project. A product life cycle is the series of phases that represent the evolution of a product, from concept through delivery, growth, maturity, and to retirement.
  • 59.
    1.2.4.2 PROJECT PHASE Aproject phase is a collection of logically related project activities that culminates in the completion of one or more deliverables. The phases in a life cycle can be described by a variety of attributes. Attributes may be measurable and unique to a specific phase. Attributes may include but are not limited to: Name (e.g., Phase A, Phase B, Phase 1, Phase 2, proposal phase), Number (e.g., three phases in the project, five phases in the project), Duration (e.g., 1 week, 1 month, 1 quarter), Resource requirements (e.g., people, buildings, equipment), Entrance criteria for a project to move into that phase (e.g., specified approvals documented, specified documents completed), and Exit criteria for a project to complete a phase (e.g., documented approvals, completed documents, completed deliverables). Projects may be separated into distinct phases or subcomponents. These phases or subcomponents are generally given names that indicate the type of work done in that phase. Examples of phase names include but are not limited to: Concept development, Feasibility study, Customer requirements, Solution development, Design, Prototype, Build, Test, Transition, Commissioning, Milestone review, and Lessons learned. The project phases may be established based on various factors including, but not limited to:
  • 60.
    Management needs; Nature ofthe project; Unique characteristics of the organization, industry, or technology; Project elements including, but not limited to, technology, engineering, business, process, or legal; and Decision points (e.g., funding, project go/no-go, and milestone review). Using multiple phases may provide better insight to managing the project. It also provides an opportunity to assess the project performance and take necessary corrective or preventive actions in subsequent phases. A key component used with project phases is the phase review (see Section 1.2.4.3). 1.2.4.3 PHASE GATE A phase gate, is held at the end of a phase. The project's performance and progress are compared to project and business documents including but not limited to: Project business case (see Section 1.2.6.1), Project charter (see Section 4.1), Project management plan (see Section 4.2), and Benefits management plan (see Section 1.2.6.2). A decision (e.g., go/no-go decision) is made as a result of this comparison to: Continue to the next phase, Continue to the next phase with modification, End the project, Remain in the phase, or Repeat the phase or elements of it. Depending on the organization, industry, or type of work, phase gates may be referred to by other terms such as, phase review, stage gate, kill point, and phase entrance or phase exit. Organizations may use these reviews to examine other pertinent items which are beyond the scope of this guide, such as product-related documents or models.
  • 61.
    1.2.4.4 PROJECT MANAGEMENTPROCESSES The project life cycle is managed by executing a series of project management activities known as project management processes. Every project management process produces one or more outputs from one or more inputs by using appropriate project management tools and techniques. The output can be a deliverable or an outcome. Outcomes are an end result of a process. Project management processes apply globally across industries. Project management processes are logically linked by the outputs they produce. Processes may contain overlapping activities that occur throughout the project. The output of one process generally results in either: An input to another process, or A deliverable of the project or project phase. Figure 1-6 shows an example of how inputs, tools and techniques, and outputs relate to each other within a process, and with other processes. The number of process iterations and interactions between processes varies based on the needs of the project. Processes generally fall into one of three categories: Processes used once or at predefined points in the project. The processes Develop Project Charter and Close Project or Phase are examples. Processes that are performed periodically as needed. The process Acquire Resources is performed as resources are needed. The process Conduct Procurements is performed prior to needing the procured item. Processes that are performed continuously throughout the project. The process Define Activities may occur throughout the project life cycle, especially if the project uses rolling wave planning or an adaptive
  • 62.
    development approach. Manyof the monitoring and control processes are ongoing from the start of the project, until it is closed out. Project management is accomplished through the appropriate application and integration of logically grouped project management processes. While there are different ways of grouping processes, the PMBOK® Guide groups processes into five categories called Process Groups. 1.2.4.5 PROJECT MANAGEMENT PROCESS GROUPS A Project Management Process Group is a logical grouping of project management processes to achieve specific project objectives. Process Groups are independent of project phases. Project management processes are grouped into the following five Project Management Process Groups: Initiating Process Group. Those processes performed to define a new project or a new phase of an existing project by obtaining authorization to start the project or phase. Planning Process Group. Those processes required to establish the scope of the project, refine the objectives, and define the course of action required to attain the objectives that the project was undertaken to achieve. Executing Process Group. Those processes performed to complete the work defined in the project management plan to satisfy the project requirements. Monitoring and Controlling Process Group. Those processes required to track, review, and regulate the progress and performance of the project; identify any areas in which changes to the plan are required; and initiate the corresponding changes. Closing Process Group. Those processes performed to formally complete or close the project, phase, or contract. Process flow diagrams are used throughout this guide. The project management processes are linked by specific inputs and outputs where the result or outcome of one process may become the input to another process that is not necessarily in the same Process Group. Note that Process Groups are not the same as project phases (see Section 1.2.4.2). 1.2.4.6 PROJECT MANAGEMENT KNOWLEDGE AREAS
  • 63.
    In addition toProcess Groups, processes are also categorized by Knowledge Areas. A Knowledge Area is an identified area of project management defined by its knowledge requirements and described in terms of its component processes, practices, inputs, outputs, tools, and techniques. Although the Knowledge Areas are interrelated, they are defined separately from the project management perspective. The ten Knowledge Areas identified in this guide are used in most projects most of the time. The ten Knowledge Areas described in this guide are: Project Integration Management. Includes the processes and activities to identify, define, combine, unify, and coordinate the various processes and project management activities within the Project Management Process Groups. Project Scope Management. Includes the processes required to ensure the project includes all the work required, and only the work required, to complete the project successfully. Project Schedule Management. Includes the processes required to manage the timely completion of the project. Project Cost Management. Includes the processes involved in planning, estimating, budgeting, financing, funding, managing, and controlling costs so the project can be completed within the approved budget. Project Quality Management. Includes the processes for incorporating the organization's quality policy regarding planning, managing, and controlling project and product quality requirements, in order to meet stakeholders’ expectations. Project Resource Management. Includes the processes to identify, acquire, and manage the resources needed for the successful completion of the project. Project Communications Management. Includes the processes required to ensure timely and appropriate planning, collection, creation, distribution, storage, retrieval, management, control, monitoring, and ultimate disposition of project information. Project Risk Management. Includes the processes of conducting risk management planning, identification, analysis, response planning, response implementation, and monitoring risk on a project.
  • 64.
    Project Procurement Management.Includes the processes necessary to purchase or acquire products, services, or results needed from outside the project team. Project Stakeholder Management. Includes the processes required to identify the people, groups, or organizations that could impact or be impacted by the project, to analyze stakeholder expectations and their impact on the project, and to develop appropriate management strategies for effectively engaging stakeholders in project decisions and execution. The needs of a specific project may require one or more additional Knowledge Areas, for example, construction may require financial management or safety and health management. Table 1-4 maps the Project Management Process Groups and Knowledge Areas. Sections 4 through 13 provide more detail about each Knowledge Area. This table is an overview of the basic processes described in Sections 4 through 13.
  • 65.
    1.2.4.7 PROJECT MANAGEMENTDATA AND INFORMATION Throughout the life cycle of a project, a significant amount of data is collected, analyzed, and transformed. Project data are collected as a result of various processes and are shared within the project team. The collected data are analyzed in context, aggregated, and transformed to become project information during various processes. Information is communicated verbally or stored and distributed in various formats as reports. See Section 4.3 for more detail on this topic. Project data are regularly collected and analyzed throughout the project life cycle. The following definitions identify key terminology regarding project data and information: Work performance data. The raw observations and measurements identified during activities performed to carry out the project work.
  • 66.
    Examples include reportedpercent of work physically completed, quality and technical performance measures, start and finish dates of schedule activities, number of change requests, number of defects, actual costs, actual durations, etc. Project data are usually recorded in a Project Management Information System (PMIS) (see Section 4.3.2.2) and in project documents. Work performance information. The performance data collected from various controlling processes, analyzed in context and integrated based on relationships across areas. Examples of performance information are status of deliverables, implementation status for change requests, and forecast estimates to complete. Work performance reports. The physical or electronic representation of work performance information compiled in project documents, which is intended to generate decisions or raise issues, actions, or awareness. Examples include status reports, memos, justifications, information notes, electronic dashboards, recommendations, and updates. Figure 1-7 shows the flow of project information across the various processes used in managing the project.
  • 67.
    1.2.5 TAILORING Usually, projectmanagers apply a project management methodology to their work. A methodology is a system of practices, techniques, procedures, and rules used by those who work in a discipline. This definition makes it clear that this guide itself is not a methodology. This guide and The Standard for Project Management [1] are recommended references for tailoring, because these standard documents identify the subset of the project management body of knowledge that is generally recognized as good practice. “Good practice” does not mean that the knowledge described should always be applied uniformly to all projects. Specific methodology recommendations are outside the scope of this guide. Project management methodologies may be:
  • 68.
    Developed by expertswithin the organization, Purchased from vendors, Obtained from professional associations, or Acquired from government agencies. The appropriate project management processes, inputs, tools, techniques, outputs, and life cycle phases should be selected to manage a project. This selection activity is known as tailoring project management to the project. The project manager collaborates with the project team, sponsor, organizational management, or some combination thereof, in the tailoring. In some cases, the organization may require specific project management methodologies be used. Tailoring is necessary because each project is unique; not every process, tool, technique, input, or output identified in the PMBOK® Guide is required on every project. Tailoring should address the competing constraints of scope, schedule, cost, resources, quality, and risk. The importance of each constraint is different for each project, and the project manager tailors the approach for managing these constraints based on the project environment, organizational culture, stakeholder needs, and other variables. In tailoring project management, the project manager should also consider the varying levels of governance that may be required and within which the project will operate, as well as considering the culture of the organization. In addition, consideration of whether the customer of the project is internal or external to the organization may affect project management tailoring decisions. Sound project management methodologies take into account the unique nature of projects and allow tailoring, to some extent, by the project manager. However, the tailoring that is included in the methodology may still require additional tailoring for a given project. 1.2.6 PROJECT MANAGEMENT BUSINESS DOCUMENTS The project manager needs to ensure that the project management approach captures the intent of business documents. These documents are defined in Table 1-5. These two documents are interdependent and iteratively developed and maintained throughout the life cycle of the project. Table 1-5. Project Business Documents
  • 69.
    Project Business DocumentsDefinition Project business case A documented economic feasibility study used to establish the validity of the benefits of a selected component lacking sufficient definition and that is used as a basis for the authorization of further project management activities. Project benefits management plan The documented explanation defining the processes for creating, maximizing, and sustaining the benefits provided by a project. The project sponsor is generally accountable for the development and maintenance of the project business case document. The project manager is responsible for providing recommendations and oversight to keep the project business case, project management plan, project charter, and project benefits management plan success measures in alignment with one another and with the goals and objectives of the organization. Project managers should appropriately tailor the noted project management documents for their projects. In some organizations, the business case and benefits management plan are maintained at the program level. Project managers should work with the appropriate program managers to ensure the project management documents are aligned with the program documents. Figure 1-8 illustrates the interrelationship of these critical project management business documents and the needs assessment. Figure 1-8 shows an approximation of the life cycle of these various documents against the project life cycle.
  • 70.
    1.2.6.1 PROJECT BUSINESSCASE The project business case is a documented economic feasibility study used to establish the validity of the benefits of a selected component lacking sufficient definition and that is used as a basis for the authorization of further project management activities. The business case lists the objectives and reasons for project initiation. It helps measure the project success at the end of the project against the project objectives. The business case is a project business document that is used throughout the project life cycle. The business case may be used before the project initiation and may result in a go/no-go decision for the project. A needs assessment often precedes the business case. The needs assessment involves understanding business goals and objectives, issues, and opportunities and recommending proposals to address them. The results of the needs assessment may be summarized in the business case document. The process of defining the business need, analyzing the situation, making recommendations, and defining evaluation criteria is applicable to any organization's projects. A business case may include but is not limited to documenting the following:
  • 71.
    Business needs: Determination ofwhat is prompting the need for action; Situational statement documenting the business problem or opportunity to be addressed including the value to be delivered to the organization; Identification of stakeholders affected; and Identification of the scope. Analysis of the situation: Identification of organizational strategies, goals, and objectives; Identification of root cause(s) of the problem or main contributors of an opportunity; Gap analysis of capabilities needed for the project versus existing capabilities of the organization; Identification of known risks; Identification of critical success factors; Identification of decision criteria by which the various courses of action may be assessed; Examples of criteria categories used for analysis of a situation are: Required. This is a criterion that is “required” to be fulfilled to address the problem or opportunity. Desired. This is a criterion that is “desired” to be fulfilled to address the problem or opportunity. Optional. This is a criterion that is not essential. Fulfillment of this criterion may become a differentiator between alternative courses of action. Identification of a set of options to be considered for addressing the business problem or opportunity. Options are alternative courses of action that may be taken by the organization. Options may also be described as business scenarios. For example, a business case could present the following three options: Do nothing. This is also referred to as the “business as usual” option. Selection of this option results in the project not being
  • 72.
    authorized. Do the minimumwork possible to address the problem or opportunity. The minimum may be established by identifying the set of documented criteria that are key in addressing the problem or opportunity. Do more than the minimum work possible to address the problem or opportunity. This option meets the minimum set of criteria and some or all of the other documented criteria. There may be more than one of these options documented in the business case. Recommendation: A statement of the recommended option to pursue in the project; Items to include in the statement may include but are not limited to: Analysis results for the potential option; Constraints, assumptions, risks, and dependencies for the potential options; and Success measures (see Section 1.2.6.4). An implementation approach that may include but is not limited to: Milestones, Dependencies, and Roles and responsibilities. Evaluation: Statement describing the plan for measuring benefits the project will deliver. This should include any ongoing operational aspects of the recommended option beyond initial implementation. The business case document provides the basis to measure success and progress throughout the project life cycle by comparing the results with the objectives and the identified success criteria. See Business Analysis for Practitioners: A Practice Guide [7]. 1.2.6.2 PROJECT BENEFITS MANAGEMENT PLAN The project benefits management plan is the document that describes how and when the benefits of the project will be delivered, and describes the mechanisms
  • 73.
    that should bein place to measure those benefits. A project benefit is defined as an outcome of actions, behaviors, products, services, or results that provide value to the sponsoring organization as well as to the project's intended beneficiaries. Development of the benefits management plan begins early in the project life cycle with the definition of the target benefits to be realized. The benefits management plan describes key elements of the benefits and may include but is not limited to documenting the following: Target benefits (e.g., the expected tangible and intangible value to be gained by the implementation of the project; financial value is expressed as net present value); Strategic alignment (e.g., how well the project benefits align to the business strategies of the organization); Timeframe for realizing benefits (e.g., benefits by phase, short-term, long-term, and ongoing); Benefits owner (e.g., the accountable person to monitor, record, and report realized benefits throughout the timeframe established in the plan); Metrics (e.g., the measures to be used to show benefits realized, direct measures, and indirect measures); Assumptions (e.g., factors expected to be in place or to be in evidence); and Risks (e.g., risks for realization of benefits). Developing the benefits management plan makes use of the data and information documented in the business case and needs assessment. For example, the cost-benefit analyses recorded in the documents illustrate the estimate of costs compared to the value of the benefits realized by the project. The benefits management plan and the project management plan include a description of how the business value resulting from the project becomes part of the organization's ongoing operations, including the metrics to be used. The metrics provide verification of the business value and validation of the project's success. Development and maintenance of the project benefits management plan is an iterative activity. This document complements the business case, project charter, and project management plan. The project manager works with the sponsor to ensure that the project charter, project management plan, and the benefits management plan remain in alignment throughout the life cycle of the project.
  • 74.
    See Business Analysisfor Practitioners: A Practice Guide [7], The Standard for Program Management [3], and The Standard for Portfolio Management [2]. 1.2.6.3 PROJECT CHARTER AND PROJECT MANAGEMENT PLAN The project charter is defined as a document issued by the project sponsor that formally authorizes the existence of a project and provides the project manager with the authority to apply organizational resources to project activities. The project management plan is defined as the document that describes how the project will be executed, monitored, and controlled. See Section 4 on Project Integration Management for more information on the project charter and the project management plan. 1.2.6.4 PROJECT SUCCESS MEASURES One of the most common challenges in project management is determining whether or not a project is successful. Traditionally, the project management metrics of time, cost, scope, and quality have been the most important factors in defining the success of a project. More recently, practitioners and scholars have determined that project success should also be measured with consideration toward achievement of the project objectives. Project stakeholders may have different ideas as to what the successful completion of a project will look like and which factors are the most important. It is critical to clearly document the project objectives and to select objectives that are measurable. Three questions that the key stakeholders and the project manager should answer are: What does success look like for this project? How will success be measured? What factors may impact success? The answer to these questions should be documented and agreed upon by the key stakeholders and the project manager. Project success may include additional criteria linked to the organizational strategy and to the delivery of business results. These project objectives may include but are not limited to:
  • 75.
    Completing the projectbenefits management plan; Meeting the agreed-upon financial measures documented in the business case. These financial measures may include but are not limited to: Net present value (NPV), Return on investment (ROI), Internal rate of return (IRR), Payback period (PBP), and Benefit-cost ratio (BCR). Meeting business case nonfinancial objectives; Completing movement of an organization from its current state to the desired future state; Fulfilling contract terms and conditions; Meeting organizational strategy, goals, and objectives; Achieving stakeholder satisfaction; Acceptable customer/end-user adoption; Integration of deliverables into the organization's operating environment; Achieving agreed-upon quality of delivery; Meeting governance criteria; and Achieving other agreed-upon success measures or criteria (e.g., process throughput). The project team needs to be able to assess the project situation, balance the demands, and maintain proactive communication with stakeholders in order to deliver a successful project. When the business alignment for a project is constant, the chance for project success greatly increases because the project remains aligned with the strategic direction of the organization. It is possible for a project to be successful from a scope/schedule/budget viewpoint, and to be unsuccessful from a business viewpoint. This can occur when there is a change in the business needs or the market environment before the project is completed.
  • 76.
    2 THE ENVIRONMENT INWHICH PROJECTS OPERATE 2.1 OVERVIEW Projects exist and operate in environments that may have an influence on them. These influences can have a favorable or unfavorable impact on the project. Two major categories of influences are enterprise environmental factors (EEFs) and organizational process assets (OPAs). EEFs originate from the environment outside of the project and often outside of the enterprise. EEFs may have an impact at the organizational, portfolio, program, or project level. See Section 2.2 for additional information on EEFs. OPAs are internal to the organization. These may arise from the organization itself, a portfolio, a program, another project, or a combination of these. Figure 2-1 shows the breakdown of project influences into EEFs and OPAs. See Section 2.3 for additional information on OPAs.
  • 77.
    In addition toEEFs and OPAs, organizational systems play a significant role in the life cycle of the project. System factors that impact the power, influence, interests, competencies, and political capabilities of the people to act within the organizational system are discussed further in the section on organizational systems (see Section 2.4). 2.2 ENTERPRISE ENVIRONMENTAL FACTORS Enterprise environmental factors (EEFs) refer to conditions, not under the control of the project team, that influence, constrain, or direct the project. These conditions can be internal and/or external to the organization. EEFs are considered as inputs to many project management processes, specifically for most planning processes. These factors may enhance or constrain project management options. In addition, these factors may have a positive or negative influence on the outcome. EEFs vary widely in type or nature. These factors need to be considered if the project is to be effective. EEFs include but are not limited to the factors described in Sections 2.2.1 and 2.2.2. 2.2.1 EEFS INTERNAL TO THE ORGANIZATION The following EEFs are internal to the organization:
  • 78.
    Organizational culture, structure,and governance. Examples include vision, mission, values, beliefs, cultural norms, leadership style, hierarchy and authority relationships, organizational style, ethics, and code of conduct. Geographic distribution of facilities and resources. Examples include factory locations, virtual teams, shared systems, and cloud computing. Infrastructure. Examples include existing facilities, equipment, organizational telecommunications channels, information technology hardware, availability, and capacity. Information technology software. Examples include scheduling software tools, configuration management systems, web interfaces to other online automated systems, and work authorization systems. Resource availability. Examples include contracting and purchasing constraints, approved providers and subcontractors, and collaboration agreements. Employee capability. Examples include existing human resources expertise, skills, competencies, and specialized knowledge. 2.2.2 EEFS EXTERNAL TO THE ORGANIZATION The following EEFs are external to the organization. Marketplace conditions. Examples include competitors, market share brand recognition, and trademarks. Social and cultural influences and issues. Examples include political climate, codes of conduct, ethics, and perceptions. Legal restrictions. Examples include country or local laws and regulations related to security, data protection, business conduct, employment, and procurement. Commercial databases. Examples include benchmarking results, standardized cost estimating data, industry risk study information, and risk databases. Academic research. Examples include industry studies, publications, and benchmarking results. Government or industry standards. Examples include regulatory
  • 79.
    agency regulations andstandards related to products, production, environment, quality, and workmanship. Financial considerations. Examples include currency exchange rates, interest rates, inflation rates, tariffs, and geographic location. Physical environmental elements. Examples include working conditions, weather, and constraints. 2.3 ORGANIZATIONAL PROCESS ASSETS Organizational process assets (OPAs) are the plans, processes, policies, procedures, and knowledge bases specific to and used by the performing organization. These assets influence the management of the project. OPAs include any artifact, practice, or knowledge from any or all of the performing organizations involved in the project that can be used to execute or govern the project. The OPAs also include the organization's lessons learned from previous projects and historical information. OPAs may include completed schedules, risk data, and earned value data. OPAs are inputs to many project management processes. Since OPAs are internal to the organization, the project team members may be able to update and add to the organizational process assets as necessary throughout the project. They may be grouped into two categories: Processes, policies, and procedures; and Organizational knowledge bases. Generally, the assets in the first category are not updated as part of the project work. Processes, policies, and procedures are usually established by the project management office (PMO) or another function outside of the project. These can be updated only by following the appropriate organizational policies associated with updating processes, policies, or procedures. Some organizations encourage the team to tailor templates, life cycles, and checklists for the project. In these instances, the project management team should tailor those assets to meet the needs of the project. The assets in the second category are updated throughout the project with project information. For example, information on financial performance, lessons learned, performance metrics and issues, and defects are continually updated throughout the project.
  • 80.
    2.3.1 PROCESSES, POLICIES,AND PROCEDURES The organization's processes and procedures for conducting project work include but are not limited to: Initiating and Planning: Guidelines and criteria for tailoring the organization's set of standard processes and procedures to satisfy the specific needs of the project; Specific organizational standards such as policies (e.g., human resources policies, health and safety policies, security and confidentiality policies, quality policies, procurement policies, and environmental policies); Product and project life cycles, and methods and procedures (e.g., project management methods, estimation metrics, process audits, improvement targets, checklists, and standardized process definitions for use in the organization); Templates (e.g., project management plans, project documents, project registers, report formats, contract templates, risk categories, risk statement templates, probability and impact definitions, probability and impact matrices, and stakeholder register templates); and Preapproved supplier lists and various types of contractual agreements (e.g., fixed-price, cost-reimbursable, and time and material contracts). Executing, Monitoring, and Controlling: Change control procedures, including the steps by which performing organization standards, policies, plans, and procedures or any project documents will be modified, and how any changes will be approved and validated; Traceability matrices; Financial controls procedures (e.g., time reporting, required expenditure and disbursement reviews, accounting codes, and standard contract provisions); Issue and defect management procedures (e.g., defining issue and defect controls, identifying and resolving issues and defects, and
  • 81.
    tracking action items); Resourceavailability control and assignment management; Organizational communication requirements (e.g., specific communication technology available, authorized communication media, record retention policies, videoconferencing, collaborative tools, and security requirements); Procedures for prioritizing, approving, and issuing work authorizations; Templates (e.g., risk register, issue log, and change log); Standardized guidelines, work instructions, proposal evaluation criteria, and performance measurement criteria; and Product, service, or result verification and validation procedures. Closing. Project closure guidelines or requirements (e.g., final project audits, project evaluations, deliverable acceptance, contract closure, resource reassignment, and knowledge transfer to production and/or operations). 2.3.2 ORGANIZATIONAL KNOWLEDGE REPOSITORIES The organizational knowledge repositories for storing and retrieving information include but are not limited to: Configuration management knowledge repositories containing the versions of software and hardware components and baselines of all performing organization standards, policies, procedures, and any project documents; Financial data repositories containing information such as labor hours, incurred costs, budgets, and any project cost overruns; Historical information and lessons learned knowledge repositories (e.g., project records and documents, all project closure information and documentation, information regarding both the results of previous project selection decisions and previous project performance information, and information from risk management activities); Issue and defect management data repositories containing issue and defect status, control information, issue and defect resolution, and
  • 82.
    action item results; Datarepositories for metrics used to collect and make available measurement data on processes and products; and Project files from previous projects (e.g., scope, cost, schedule, and performance measurement baselines, project calendars, project schedule network diagrams, risk registers, risk reports, and stakeholder registers). 2.4 ORGANIZATIONAL SYSTEMS 2.4.1 OVERVIEW Projects operate within the constraints imposed by the organization through their structure and governance framework. To operate effectively and efficiently, the project manager needs to understand where responsibility, accountability, and authority reside within the organization. This understanding will help the project manager effectively use his or her power, influence, competence, leadership, and political capabilities to successfully complete the project. The interaction of multiple factors within an individual organization creates a unique system that impacts the project operating in that system. The resulting organizational system determines the power, influence, interests, competence, and political capabilities of the people who are able to act within the system. The system factors include but are not limited to: Management elements, Governance frameworks, and Organizational structure types. The complete information and explanation of the organizational system factors and how the combination of these factors impacts a project are beyond the scope of this guide. There are disciplines with associated literature, methodologies, and practices that address these factors in more depth than is possible within this guide. This section provides an overview of these factors and their interrelationship. This overview begins by discussing systems in general. A system is a collection of various components that together can produce results not obtainable
  • 83.
    by the individualcomponents alone. A component is an identifiable element within the project or organization that provides a particular function or group of related functions. The interaction of the various system components creates the organizational culture and capabilities. There are several principles regarding systems: Systems are dynamic, Systems can be optimized, System components can be optimized, Systems and their components cannot be optimized at the same time, and Systems are nonlinear in responsiveness (a change in the input does not produce a predictable change in the output). Multiple changes may occur within the system and between the system and its environment. When these changes take place, adaptive behavior occurs within the components that in turn add to the system's dynamics. The system's dynamics are defined by the interaction between the components based on the relationships and dependencies that exist between the components. Systems are typically the responsibility of an organization's management. The organization's management examines the optimization trade-offs between the components and the system in order to take the appropriate action to achieve the best outcomes for the organization. The results of this examination will impact the project under consideration. Therefore, it is important that the project manager take these results into account when determining how to fulfill the project's objectives. In addition, the project manager should take into account the organization's governance framework. 2.4.2 ORGANIZATIONAL GOVERNANCE FRAMEWORKS Recent PMI research reveals that governance refers to organizational or structural arrangements at all levels of an organization designed to determine and influence the behavior of the organization's members [9]. This research suggests that the concept of governance is multidimensional and: Includes consideration of people, roles, structures, and policies; and Requires providing direction and oversight through data and feedback.
  • 84.
    2.4.2.1 GOVERNANCE FRAMEWORK Governanceis the framework within which authority is exercised in organizations. This framework includes but is not limited to: Rules, Policies, Procedures, Norms, Relationships, Systems, and Processes. This framework influences how: Objectives of the organization are set and achieved, Risk is monitored and assessed, and Performance is optimized. 2.4.2.2 GOVERNANCE OF PORTFOLIOS, PROGRAMS, AND PROJECTS The Governance of Portfolios, Programs, and Projects: A Practice Guide [10] describes a common governance framework aligning organizational project management (OPM) and portfolio, program, and project management. The practice guide describes four governance domains of alignment, risk, performance, and communications. Each domain has the following functions: oversight, control, integration, and decision making. Each function has governance supporting processes and activities for stand-alone projects, or projects operating within the portfolio or program environments. Project governance refers to the framework, functions, and processes that guide project management activities in order to create a unique product, service, or result to meet organizational, strategic, and operational goals. There is no one governance framework that is effective in all organizations. A governance framework should be tailored to the organizational culture, types of projects, and the needs of the organization in order to be effective. For more information regarding project governance, including its implementation, see Governance of Portfolios, Programs, and Projects: A Practice Guide [10].
  • 85.
    2.4.3 MANAGEMENT ELEMENTS Managementelements are the components that comprise the key functions or principles of general management in the organization. The general management elements are allocated within the organization according to its governance framework and the organizational structure type selected. The key functions or principles of management include but are not limited to: Division of work using specialized skills and availability to perform work; Authority given to perform work; Responsibility to perform work appropriately assigned based on such attributes as skill and experience; Discipline of action (e.g., respect for authority, people, and rules); Unity of command (e.g., only one person gives orders for any action or activity to an individual); Unity of direction (e.g., one plan and one head for a group of activities with the same objective); General goals of the organization take precedence over individual goals; Paid fairly for work performed; Optimal use of resources; Clear communication channels; Right materials to the right person for the right job at the right time; Fair and equal treatment of people in the workplace; Clear security of work positions; Safety of people in the workplace; Open contribution to planning and execution by each person; and Optimal morale. Performance of these management elements are assigned to selected individuals within the organization. These individuals may perform the noted functions within various organizational structures. For example, in a hierarchical structure, there are horizontal and vertical levels within the organization. These hierarchical levels range from the line management level through to the
  • 86.
    executive management level.The responsibility, accountability, and authority assigned to the hierarchical level indicate how the individual may perform the noted function within that organizational structure. 2.4.4 ORGANIZATIONAL STRUCTURE TYPES Determination of the appropriate organizational structure type is a result of the study of tradeoffs between two key variables. The variables are the organizational structure types available for use and how to optimize them for a given organization. There is not a one-size-fits-all structure for any given organization. The final structure for a given organization is unique due to the numerous variables to be considered. Sections 2.4.4.1 and 2.4.4.2 give examples of some of the factors to be included when considering the two variables given. Section 2.4.4.3 discusses one organizational structure that is prevalent in project management. 2.4.4.1 ORGANIZATIONAL STRUCTURE TYPES Organizational structures take many forms or types. Table 2-1 compares several types of organizational structures and their influence on projects. 2.4.4.2 FACTORS IN ORGANIZATION STRUCTURE SELECTION Each organization considers numerous factors for inclusion in its organizational structure. Each factor may carry a different level of importance in the final analysis. The combination of the factor, its value, and relative importance provides the organization's decision makers with the right information for inclusion in the analysis. Factors to consider in selecting an organizational structure include but are not limited to: Degree of alignment with organizational objectives, Specialization capabilities, Span of control, efficiency, and effectiveness, Clear path for escalation of decisions, Clear line and scope of authority, Delegation capabilities, Accountability assignment,
  • 87.
    Responsibility assignment, Adaptability ofdesign, Simplicity of design, Efficiency of performance, Cost considerations, Physical locations (e.g., colocated, regional, and virtual), and Clear communication (e.g., policies, status of work, and organization's vision). 2.4.4.3 PROJECT MANAGEMENT OFFICE A project management office (PMO) is an organizational structure that standardizes the project-related governance processes and facilitates the sharing of resources, methodologies, tools, and techniques. The responsibilities of a PMO can range from providing project management support functions to the
  • 88.
    direct management ofone or more projects. There are several types of PMOs in organizations. Each type varies in the degree of control and influence it has on projects within the organization, such as: Supportive. Supportive PMOs provide a consultative role to projects by supplying templates, best practices, training, access to information, and lessons learned from other projects. This type of PMO serves as a project repository. The degree of control provided by the PMO is low. Controlling. Controlling PMOs provide support and require compliance through various means. The degree of control provided by the PMO is moderate. Compliance may involve: Adoption of project management frameworks or methodologies; Use of specific templates, forms, and tools; and Conformance to governance frameworks. Directive. Directive PMOs take control of the projects by directly managing the projects. Project managers are assigned by and report to the PMO. The degree of control provided by the PMO is high. The project management office may have organization-wide responsibility. It may play a role in supporting strategic alignment and delivering organizational value. The PMO integrates data and information from organizational strategic projects and evaluates how higher-level strategic objectives are being fulfilled. The PMO is the natural liaison between the organization's portfolios, programs, projects, and the organizational measurement systems (e.g., balanced scorecard). The projects supported or administered by the PMO may not be related other than by being managed together. The specific form, function, and structure of a PMO are dependent upon the needs of the organization that it supports. A PMO may have the authority to act as an integral stakeholder and a key decision maker throughout the life of each project in order to keep it aligned with the business objectives. The PMO may: Make recommendations, Lead knowledge transfer, Terminate projects, and Take other actions, as required.
  • 89.
    A primary functionof a PMO is to support project managers in a variety of ways, which may include but are not limited to: Managing shared resources across all projects administered by the PMO; Identifying and developing project management methodology, best practices, and standards; Coaching, mentoring, training, and oversight; Monitoring compliance with project management standards, policies, procedures, and templates by means of project audits; Developing and managing project policies, procedures, templates, and other shared documentation (organizational process assets); and Coordinating communication across projects.
  • 90.
    3 THE ROLE OFTHE PROJECT MANAGER 3.1 OVERVIEW The project manager plays a critical role in the leadership of a project team in order to achieve the project's objectives. This role is clearly visible throughout the project. Many project managers become involved in a project from its initiation through closing. However, in some organizations, a project manager may be involved in evaluation and analysis activities prior to project initiation. These activities may include consulting with executive and business unit leaders on ideas for advancing strategic objectives, improving organizational performance, or meeting customer needs. In some organizational settings, the project manager may also be called upon to manage or assist in business analysis, business case development, and aspects of portfolio management for a project. A project manager may also be involved in follow-on activities related to realizing business benefits from the project. The role of a project manager may vary from organization to organization. Ultimately, the project management role is tailored to fit the organization in the same way that the project management processes are tailored to fit the project. A simple analogy may help in understanding the roles of a project manager for a large project by comparing them to the roles of a conductor for a large orchestra: Membership and roles. A large project and an orchestra each comprise many members, each playing a different role. A large orchestra may have more than 100 musicians who are led by a conductor. These musicians may play 25 different kinds of instruments placed into major sections, such as strings, woodwinds, brass, and percussion. Similarly, a large project may have more than 100 project members led by a project manager. Team members may fulfill many different roles,
  • 91.
    such as design,manufacturing, and facilities management. Like the major sections of the orchestra, they represent multiple business units or groups within an organization. The musicians and the project members make up each leader's team. Responsibility for team. The project manager and conductor are both responsible for what their teams produce—the project outcome or the orchestra concert, respectively. The two leaders need to take a holistic view of their team's products in order to plan, coordinate, and complete them. The two leaders begin by reviewing the vision, mission, and objectives of their respective organizations to ensure alignment with their products. The two leaders establish their interpretation of the vision, mission, and objectives involved in successfully completing their products. The leaders use their interpretation to communicate and motivate their teams toward the successful completion of their objectives. Knowledge and skills: The conductor is not expected to be able to play every instrument in the orchestra, but should possess musical knowledge, understanding, and experience. The conductor provides the orchestra with leadership, planning, and coordination through communications. The conductor provides written communication in the form of musical scores and practice schedules. The conductor also communicates in real time with the team by using a baton and other body movements. The project manager is not expected to perform every role on the project, but should possess project management knowledge, technical knowledge, understanding, and experience. The project manager provides the project team with leadership, planning, and coordination through communications. The project manager provides written communications (e.g., documented plans and schedules) and communicates in real time with the team using meetings and verbal or nonverbal cues. The remainder of this section covers the key aspects of the role of the project manager. While there are thousands of books and articles available on the subject, this section is not intended to cover the entire spectrum of information available. Rather, it is designed to present an overview that will provide the practitioner with a basic understanding of the subject in preparation for a more concentrated study on the various aspects discussed.
  • 92.
    3.2 DEFINITION OFA PROJECT MANAGER The role of a project manager is distinct from that of a functional manager or operations manager. Typically, the functional manager focuses on providing management oversight for a functional or business unit. Operations managers are responsible for ensuring that business operations are efficient. The project manager is the person assigned by the performing organization to lead the team that is responsible for achieving the project objectives. 3.3 THE PROJECT MANAGER'S SPHERE OF INFLUENCE 3.3.1 OVERVIEW Project managers fulfill numerous roles within their sphere of influence. These roles reflect the project manager's capabilities and are representative of the value and contributions of the project management profession. This section highlights the roles of the project manager in the various spheres of influence shown in Figure 3-1.
  • 93.
    3.3.2 THE PROJECT Theproject manager leads the project team to meet the project's objectives and stakeholders’ expectations. The project manager works to balance the competing constraints on the project with the resources available. The project manager also performs communication roles between the project sponsor, team members, and other stakeholders. This includes providing direction and presenting the vision of success for the project. The project manager uses soft skills (e.g., interpersonal skills and the ability to manage people) to balance the conflicting and competing goals of the project stakeholders in order to achieve consensus. In this context, consensus means that the relevant stakeholders support the project decisions and actions even when there is not 100% agreement. Research shows that successful project managers consistently and effectively use certain essential skills. Research reveals that the top 2% of project managers
  • 94.
    as designated bytheir bosses and team members distinguish themselves by demonstrating superior relationship and communication skills while displaying a positive attitude [12]. The ability to communicate with stakeholders, including the team and sponsors applies across multiple aspects of the project including, but not limited to, the following: Developing finely tuned skills using multiple methods (e.g., verbal, written, and nonverbal); Creating, maintaining, and adhering to communications plans and schedules; Communicating predictably and consistently; Seeking to understand the project stakeholders’ communication needs (communication may be the only deliverable that some stakeholders received until the project's end product or service is completed); Making communications concise, clear, complete, simple, relevant, and tailored; Including important positive and negative news; Incorporating feedback channels; and Relationship skills involving the development of extensive networks of people throughout the project manager's spheres of influence. These networks include formal networks such as organizational reporting structures. However, the informal networks that project managers develop, maintain, and nurture are more important. Informal networks include the use of established relationships with individuals such as subject matter experts and influential leaders. Use of these formal and informal networks allows the project manager to engage multiple people in solving problems and navigating the bureaucracies encountered in a project. 3.3.3 THE ORGANIZATION The project manager proactively interacts with other project managers. Other independent projects or projects that are part of the same program may impact a project due to but not limited to the following: Demands on the same resources,
  • 95.
    Priorities of funding, Receiptor distribution of deliverables, and Alignment of project goals and objectives with those of the organization. Interacting with other project managers helps to create a positive influence for fulfilling the various needs of the project. These needs may be in the form of human, technical, or financial resources and deliverables required by the team for project completion. The project manager seeks ways to develop relationships that assist the team in achieving the goals and objectives of the project. In addition, the project manager maintains a strong advocacy role within the organization. The project manager proactively interacts with managers within the organization during the course of the project. The project manager also works with the project sponsor to address internal political and strategic issues that may impact the team or the viability or quality of the project. The project manager may work toward increasing the project management competency and capability within the organization as a whole and is involved in both tacit and explicit knowledge transfer or integration initiatives (see Section 4.4 on Manage Project Knowledge). The project manager also works to: Demonstrate the value of project management, Increase acceptance of project management in the organization, and Advance the efficacy of the PMO when one exists in the organization. Depending on the organizational structure, a project manager may report to a functional manager. In other cases, a project manager may be one of several project managers who report to a PMO or a portfolio or program manager who is ultimately responsible for one or more organization-wide projects. The project manager works closely with all relevant managers to achieve the project objectives and to ensure the project management plan aligns with the portfolio or program plan. The project manager also works closely and in collaboration with other roles, such as organizational managers, subject matter experts, and those involved with business analysis. In some situations, the project manager may be an external consultant placed in a temporary management role. 3.3.4 THE INDUSTRY The project manager stays informed about current industry trends. The project
  • 96.
    manager takes thisinformation and sees how it may impact or apply to the current projects. These trends include but are not limited to: Product and technology development; New and changing market niches; Standards (e.g., project management, quality management, information security management); Technical support tools; Economic forces that impact the immediate project; Influences affecting the project management discipline; and Process improvement and sustainability strategies. 3.3.5 PROFESSIONAL DISCIPLINE Continuing knowledge transfer and integration is very important for the project manager. This professional development is ongoing in the project management profession and in other areas where the project manager maintains subject matter expertise. This knowledge transfer and integration includes but is not limited to: Contribution of knowledge and expertise to others within the profession at the local, national, and global levels (e.g., communities of practice, international organizations); and Participation in training, continuing education, and development: In the project management profession (e.g., universities, PMI); In a related profession (e.g., systems engineering, configuration management); and In other professions (e.g., information technology, aerospace). 3.3.6 ACROSS DISCIPLINES A professional project manager may choose to orient and educate other professionals regarding the value of a project management approach to the organization. The project manager may serve as an informal ambassador by educating the organization as to the advantages of project management with
  • 97.
    regard to timeliness,quality, innovation, and resource management. 3.4 PROJECT MANAGER COMPETENCES 3.4.1 OVERVIEW Recent PMI studies applied the Project Manager Competency Development (PMCD) Framework to the skills needed by project managers through the use of The PMI Talent Triangle® shown in Figure 3-2. The talent triangle focuses on three key skill sets: Technical project management. The knowledge, skills, and behaviors related to specific domains of project, program, and portfolio management. The technical aspects of performing one's role. Leadership. The knowledge, skills, and behaviors needed to guide, motivate, and direct a team, to help an organization achieve its business goals. Strategic and business management. The knowledge of and expertise in the industry and organization that enhanced performance and better delivers business outcomes.
  • 98.
    While technical projectmanagement skills are core to program and project management, PMI research indicates that they are not enough in today's increasingly complicated and competitive global marketplace. Organizations are seeking added skills in leadership and business intelligence. Members of various organizations state their belief that these competencies can support longer-range strategic objectives that contribute to the bottom line. To be the most effective, project managers need to have a balance of these three skill sets. 3.4.2 TECHNICAL PROJECT MANAGEMENT SKILLS Technical project management skills are defined as the skills to effectively apply project management knowledge to deliver the desired outcomes for programs or projects. There are numerous technical project management skills. The Knowledge Areas in this guide describe many of these necessary project management skills. Project managers frequently rely on expert judgment to perform well. Being aware of personal expertise and where to find others with
  • 99.
    the needed expertiseare important for success as a project manager. According to research. the top project managers consistently demonstrated several key skills including, but not limited to, the ability to: Focus on the critical technical project management elements for each project they manage. This focus is as simple as having the right artifacts readily available. At the top of the list were the following: Critical success factors for the project, Schedule, Selected financial reports, and Issue log. Tailor both traditional and agile tools, techniques, and methods for each project. Make time to plan thoroughly and prioritize diligently. Manage project elements, including, but not limited to, schedule, cost, resources, and risks. 3.4.3 STRATEGIC AND BUSINESS MANAGEMENT SKILLS Strategic and business management skills involve the ability to see the high- level overview of the organization and effectively negotiate and implement decisions and actions that support strategic alignment and innovation. This ability may include a working knowledge of other functions such as finance, marketing, and operations. Strategic and business management skills may also include developing and applying pertinent product and industry expertise. This business knowledge is also known as domain knowledge. Project managers should be knowledgeable enough about the business to be able to: Explain to others the essential business aspects of a project; Work with the project sponsor, team, and subject matter experts to develop an appropriate project delivery strategy; and Implement that strategy in a way that maximizes the business value of the project. In order to make the best decisions regarding the successful delivery of their projects, project managers should seek out and consider the expertise of the
  • 100.
    operational managers whorun the business in their organization. These managers should know the work performed in their organization and how project plans will affect that work. The more the project manager is able to know about the project's subject matter, the better. At a minimum, the project manager should be knowledgeable enough to explain to others the following aspects of the organization: Strategy; Mission; Goals and objectives; Products and services; Operations (e.g., location, type, technology); The market and the market condition, such as customers, state of the market (i.e., growing or shrinking), and time-to-market factors, etc.; and Competition (e.g., what, who, position in the market place). The project manager should apply the following knowledge and information about the organization to the project to ensure alignment: Strategy, Mission, Goals and objectives, Priority, Tactics, and Products or services (e.g., deliverables). Strategic and business skills help the project manager to determine which business factors should be considered for their project. The project manager determines how these business and strategic factors could affect the project while understanding the interrelationship between the project and the organization. These factors include but are not limited to: Risks and issues, Financial implications, Cost versus benefits analysis (e.g., net present value, return on investment), including the various options considered,
  • 101.
    Business value, Benefits realizationexpectations and strategies, and Scope, budget, schedule, and quality. Through the application of this business knowledge, a project manager has the ability to make the appropriate decisions and recommendations for a project. As conditions change, the project manager should be continuously working with the project sponsor to keep the business and the project strategies aligned. 3.4.4 LEADERSHIP SKILLS Leadership skills involve the ability to guide, motivate, and direct a team. These skills may include demonstrating essential capabilities such as negotiation, resilience, communication, problem solving, critical thinking, and interpersonal skills. Projects are becoming increasingly more complicated with more and more businesses executing their strategy through projects. Project management is more than just working with numbers, templates, charts, graphs, and computing systems. A common denominator in all projects is people. People can be counted, but they are not numbers. 3.4.4.1 DEALING WITH PEOPLE A large part of the project manager's role involves dealing with people. The project manager should study people's behaviors and motivations. The project manager should strive to be a good leader, because leadership is crucial to the success of projects in organizations. A project manager applies leadership skills and qualities when working with all project stakeholders, including the project team, the steering team, and project sponsors. 3.4.4.2 QUALITIES AND SKILLS OF A LEADER Research shows that the qualities and skills of a leader include but are not limited to: Being a visionary (e.g., help to describe the products, goals, and objectives of the project; able to dream and translate those dreams for others); Being optimistic and positive; Being collaborative;
  • 102.
    Managing relationships andconflict by: Building trust; Satisfying concerns; Seeking consensus; Balancing competing and opposing goals; Applying persuasion, negotiation, compromise, and conflict resolution skills; Developing and nurturing personal and professional networks; Taking a long-term view that relationships are just as important as the project; and Continuously developing and applying political acumen. Communicating by: Spending sufficient time communicating (research shows that top project managers spend about 90% of their time on a project in communicating); Managing expectations; Accepting feedback graciously; Giving feedback constructively; and Asking and listening. Being respectful (helping others retain their autonomy), courteous, friendly, kind, honest, trustworthy, loyal, and ethical; Exhibiting integrity and being culturally sensitive, courageous, a problem solver, and decisive; Giving credit to others where due; Being a life-long learner who is results- and action-oriented; Focusing on the important things, including: Continuously prioritizing work by reviewing and adjusting as necessary; Finding and using a prioritization method that works for them and the project;
  • 103.
    Differentiating high-level strategicpriorities, especially those related to critical success factors for the project; Maintaining vigilance on primary project constraints; Remaining flexible on tactical priorities; and Being able to sift through massive amounts of information to obtain the most important information. Having a holistic and systemic view of the project, taking into account internal and external factors equally; Being able to apply critical thinking (e.g., application of analytical methods to reach decisions) and identify him or herself as a change agent. Being able to build effective teams, be service-oriented, and have fun and share humor effectively with team members. 3.4.4.3 POLITICS, POWER, AND GETTING THINGS DONE Leadership and management are ultimately about being able to get things done. The skills and qualities noted help the project manager to achieve the project goals and objectives. At the root of many of these skills and qualities is the ability to deal with politics. Politics involves influence, negotiation, autonomy, and power. Politics and its associated elements are not “good” or “bad,” “positive” or “negative” alone. The better the project manager understands how the organization works, the more likely he or she will be successful. The project manager observes and collects data about the project and organizational landscapes. The data then needs to be reviewed in the context of the project, the people involved, the organization, and the environment as a whole. This review yields the information and knowledge necessary for the project manager to plan and implement the most appropriate action. The project manager's action is a result of selecting the right kind of power to influence and negotiate with others. Exercise of power also carries with it the responsibility of being sensitive to and respectful of other people. The effective action of the project manager maintains the autonomy of those involved. The project manager's action results in the right people performing the activities necessary to fulfill the project's objectives. Power can originate with traits exhibited by the individual or the organization. Power is often supported by other people's perception of the leader. It is essential
  • 104.
    for project managersto be aware of their relationships with other people. Relationships enable project managers to get things done on the project. There are numerous forms of power at the disposal of project managers. Power and its use can be complex given its nature and the various factors at play in a project. Various forms of power include but are not limited to: Positional (sometimes called formal, authoritative, legitimate) (e.g., formal position granted in the organization or team); Informational (e.g., control of gathering or distribution); Referent (e.g., respect or admiration others hold for the individual, credibility gained); Situational (e.g., gained due to unique situation such as a specific crisis); Personal or charismatic (e.g., charm, attraction); Relational (e.g., participates in networking, connections, and alliances); Expert (e.g., skill, information possessed; experience, training, education, certification); Reward-oriented (e.g., ability to give praise, monetary or other desired items); Punitive or coercive (e.g., ability to invoke discipline or negative consequences); Ingratiating (e.g., application of flattery or other common ground to win favor or cooperation); Pressure-based (e.g., limit freedom of choice or movement for the purpose of gaining compliance to desired action); Guilt-based (e.g., imposition of obligation or sense of duty); Persuasive (e.g., ability to provide arguments that move people to a desired course of action); and Avoiding (e.g., refusing to participate). Top project managers are proactive and intentional when it comes to power. These project managers will work to acquire the power and authority they need within the boundaries of organizational policies, protocols, and procedures rather than wait for it to be granted.
  • 105.
    3.4.5 COMPARISON OFLEADERSHIP AND MANAGEMENT The words leadership and management are often used interchangeably. However, they are not synonymous. The word management is more closely associated with directing another person to get from one point to another using a known set of expected behaviors. In contrast, leadership involves working with others through discussion or debate in order to guide them from one point to another. The method that a project manager chooses to employ reveals a distinct difference in behavior, self-perception, and project role. Table 3-1 compares management and leadership on several important levels. Project managers need to employ both leadership and management in order to be successful. The skill is in finding the right balance for each situation. The way in which management and leadership are employed often shows up in the project manager's leadership style. Table 3-1. Team Management and Team Leadership Compared Management Leadership Direct using positional power Guide, influence, and collaborate using relational power Maintain Develop Administrate Innovate Focus on systems and structure Focus on relationships with people Rely on control Inspire trust Focus on near-term goals Focus on long-range vision Ask how and when Ask what and why Focus on bottom line Focus on the horizon Accept status quo Challenge status quo Do things right Do the right things Focus on operational issues and problem solving Focus on vision, alignment, motivation, and inspiration 3.4.5.1 LEADERSHIP STYLES
  • 106.
    Project managers maylead their teams in many ways. The style a project manager selects may be a personal preference, or the result of the combination of multiple factors associated with the project. The style a project manager uses may change over time based on the factors in play. Major factors to consider include but are not limited to: Leader characteristics (e.g., attitudes, moods, needs, values, ethics); Team member characteristics (e.g., attitudes, moods, needs, values, ethics); Organizational characteristics (e.g., its purpose, structure, and type of work performed); and Environmental characteristics (e.g., social situation, economic state, and political elements). Research describes numerous leadership styles that a project manager can adopt. Some of the most common examples of these styles include but are not limited to: Laissez-faire (e.g., allowing the team to make their own decisions and establish their own goals, also referred to as taking a hands-off style); Transactional (e.g., focus on goals, feedback, and accomplishment to determine rewards; management by exception); Servant leader (e.g., demonstrates commitment to serve and put other people first; focuses on other people's growth, learning, development, autonomy, and well-being; concentrates on relationships, community and collaboration; leadership is secondary and emerges after service); Transformational (e.g., empowering followers through idealized attributes and behaviors, inspirational motivation, encouragement for innovation and creativity, and individual consideration); Charismatic (e.g., able to inspire; is high-energy, enthusiastic, self- confident; holds strong convictions); and Interactional (e.g., a combination of transactional, transformational, and charismatic). 3.4.5.2 PERSONALITY Personality refers to the individual differences in characteristic patterns of thinking, feeling, and behaving. Personality characteristics or traits include but
  • 107.
    are not limitedto: Authentic (e.g., accepts others for what and who they are, show open concern); Courteous (e.g., ability to apply appropriate behavior and etiquette); Creative (e.g., ability to think abstractly, to see things differently, to innovate); Cultural (e.g., measure of sensitivity to other cultures including values, norms, and beliefs); Emotional (e.g., ability to perceive emotions and the information they present and to manage them; measure of interpersonal skills); Intellectual (e.g., measure of human intelligence over multiple aptitudes); Managerial (e.g., measure of management practice and potential); Political (e.g., measure of political intelligence and making things happen); Service-oriented (e.g., evidence of willingness to serve other people); Social (e.g., ability to understand and manage people); and Systemic (e.g., drive to understand and build systems). An effective project manager will have some level of ability with each of these characteristics in order to be successful. Each project, organization, and situation requires that the project manager emphasize different aspects of personality. 3.5 PERFORMING INTEGRATION The role of the project manager is twofold when performing integration on the project: Project managers play a key role in working with the project sponsor to understand the strategic objectives and ensure the alignment of the project objectives and results with those of the portfolio, program, and business areas. In this way, project managers contribute to the integration and execution of the strategy. Project managers are responsible for guiding the team to work together
  • 108.
    to focus onwhat is really essential at the project level. This is achieved through the integration of processes, knowledge, and people. Integration is a critical skill for project managers. Integration is covered more in depth in the Project Integration Management Knowledge Area of this guide. Sections 3.5.1 through 3.5.4 focus on integration that takes place at three different levels: the process, cognitive, and context levels. Section 3.5.4 concludes by addressing complexity and integration. 3.5.1 PERFORMING INTEGRATION AT THE PROCESS LEVEL Project management may be seen as a set of processes and activities that are undertaken to achieve the project objectives. Some of these processes may take place once (e.g., the initial creation of the project charter), but many others overlap and occur several times throughout the project. One example of this process overlap and multiple occurrences is a change in a requirement that impacts scope, schedule, or budget and requires a change request. Several project management processes such as the Control Scope process and the Perform Integrated Change Control process may involve a change request. The Perform Integrated Change Control process occurs throughout the project for integrating change requests. Although there is no stated definition on how to integrate the project processes, it is clear that a project has a small chance of meeting its objective when the project manager fails to integrate the project processes where they interact. 3.5.2 INTEGRATION AT THE COGNITIVE LEVEL There are many different ways to manage a project, and the method selected typically depends on the specific characteristics of the project including its size, how complicated the project or organization may be, and the culture of the performing organization. It is clear that the personal skills and abilities of the project manager are closely related to the way in which the project is managed. The project manager should strive to become proficient in all of the Project Management Knowledge Areas. In concert with proficiency in these Knowledge Areas, the project manager applies experience, insight, leadership, and technical and business management skills to the project. Finally, it is through the project manager's ability to integrate the processes in these Knowledge Areas that makes
  • 109.
    it possible toachieve the desired project results. 3.5.3 INTEGRATION AT THE CONTEXT LEVEL There have been many changes in the context in which business and projects take place today compared to a few decades ago. New technologies have been introduced. Social networks, multicultural aspects, virtual teams, and new values are part of the new reality of projects. An example is knowledge and people integration in the context of a large cross-functional project implementation involving multiple organizations. The project manager considers the implications of this context in communications planning and knowledge management for guiding the project team. Project managers need to be cognizant of the project context and these new aspects when managing the integration. Then project managers can decide how to best use these new elements of the environment in their projects to achieve success. 3.5.4 INTEGRATION AND COMPLEXITY Some projects may be referred to as complex and considered difficult to manage. In simple terms, complex and complicated are concepts often used to describe what is considered to be intricate or complicated. Complexity within projects is a result of the organization's system behavior, human behavior, and the uncertainty at work in the organization or its environment. In Navigating Complexity: A Practice Guide [13], these three dimensions of complexity are defined as: System behavior. The interdependencies of components and systems. Human behavior. The interplay between diverse individuals and groups. Ambiguity. Uncertainty of emerging issues and lack of understanding or confusion. Complexity itself is a perception of an individual based on personal experience, observation, and skill. Rather than being complex, a project is more accurately described as containing complexity. Portfolios, programs, and projects may contain elements of complexity. When approaching the integration of a project, the project manager should
  • 110.
    consider elements thatare both inside and outside of the project. The project manager should examine the characteristics or properties of the project. Complexity as a characteristic or property of a project is typically defined as: Containing multiple parts, Possessing a number of connections between the parts, Exhibiting dynamic interactions between the parts, and Exhibiting behavior produced as a result of those interactions that cannot be explained as the simple sum of the parts (e.g., emergent behavior). Examining these various items that appear to make the project complex should help the project manager identify key areas when planning, managing, and controlling the project to ensure integration.
  • 111.
    4 PROJECT INTEGRATION MANAGEMENT ProjectIntegration Management includes the processes and activities to identify, define, combine, unify, and coordinate the various processes and project management activities within the Project Management Process Groups. In the project management context, integration includes characteristics of unification, consolidation, communication, and interrelationship. These actions should be applied from the start of the project through completion. Project Integration Management includes making choices about: Resource allocation, Balancing competing demands, Examining any alternative approaches, Tailoring the processes to meet the project objectives, and Managing the interdependencies among the Project Management Knowledge Areas. The Project Integration Management processes are: 4.1 Develop Project Charter—The process of developing a document that formally authorizes the existence of a project and provides the project manager with the authority to apply organizational resources to project activities. 4.2 Develop Project Management Plan—The process of defining, preparing, and coordinating all plan components and consolidating them into an integrated project management plan. 4.3 Direct and Manage Project Work—The process of leading and performing the work defined in the project management plan and implementing approved changes to achieve the project's objectives. 4.4 Manage Project Knowledge—The process of using existing knowledge and creating new knowledge to achieve the project's objectives and contribute to organizational learning.
  • 112.
    4.5 Monitor andControl Project Work—The process of tracking, reviewing, and reporting overall progress to meet the performance objectives defined in the project management plan. 4.6 Perform Integrated Change Control—The process of reviewing all change requests; approving changes and managing changes to deliverables, organizational process assets, project documents, and the project management plan; and communicating the decisions. 4.7 Close Project or Phase—The process of finalizing all activities for the project, phase, or contract. Figure 4-1 provides an overview of the Project Integration Management processes. The Project Integration Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 113.
    KEY CONCEPTS FORPROJECT INTEGRATION MANAGEMENT Project Integration Management is specific to project managers. Whereas other Knowledge Areas may be managed by specialists (e.g., cost analysis, scheduling specialists, risk management experts), the accountability of Project Integration Management cannot be delegated or transferred. The project manager is the one who combines the results in all the other Knowledge Areas and has the overall view of the project. The project manager is ultimately responsible for the project as a whole. Projects and project management are integrative by nature. For example, a cost estimate needed for a contingency plan involves integrating the processes in the Project Cost Management, Project Schedule Management, and Project Risk Management Knowledge Areas. When additional risks associated with various staffing alternatives are identified, then one or more of those processes may be revisited. The links among the processes in the Project Management Process Groups are often iterative. For example, the Planning Process Group provides the Executing Process Group with a documented project management plan early in the project and then updates the project management plan if changes occur as the project progresses. Project Integration Management is about: Ensuring that the deliverable due dates of the product, service, or result; project life cycle; and the benefits management plan are aligned; Providing a project management plan to achieve the project objectives; Ensuring the creation and the use of the appropriate knowledge to and from the project as necessary; Managing the performance and changes of the activities in the project management plan; Making integrated decisions regarding key changes impacting the project; Measuring and monitoring the project's progress and taking appropriate action to meet project objectives; Collecting data on the results achieved, analyzing the data to obtain information, and communicating this information to relevant stakeholders;
  • 114.
    Completing all thework of the project and formally closing each phase, contract, and the project as a whole; and Managing phase transitions when necessary. The more complex the project and the more varied the expectations of the stakeholders, the more a sophisticated approach to integration is needed. TRENDS AND EMERGING PRACTICES IN PROJECT INTEGRATION MANAGEMENT The Project Integration Management Knowledge Area requires combining the results from all the other Knowledge Areas. Evolving trends in integration processes include but are not limited to: Use of automated tools. The volume of data and information that project managers need to integrate makes it necessary to use a project management information system (PMIS) and automated tools to collect, analyze, and use information to meet project objectives and realize project benefits. Use of visual management tools. Some project teams use visual management tools, rather than written plans and other documents, to capture and oversee critical project elements. Making key project elements visible to the entire team provides a real-time overview of the project status, facilitates knowledge transfer, and empowers team members and other stakeholders to help identify and solve issues. Project knowledge management. The increasingly mobile and transitory work force requires a more rigorous process of identifying knowledge throughout the project life cycle and transferring it to the target audience so that the knowledge is not lost. Expanding the project manager's responsibilities. Project managers are being called on to initiate and finalize the project, such as project business case development and benefits management. Historically, these activities have been the responsibility of management and the project management office, but project managers are more frequently collaborating with them to better meet project objectives and deliver benefits. Project managers are also engaging in more comprehensive identification and engagement of stakeholders. This includes managing the interfaces with various functional and operational departments and senior management personnel.
  • 115.
    Hybrid methodologies. Someproject management methodologies are evolving to incorporate successfully applied new practices. Examples include the use of agile and other iterative practices; business analysis techniques for requirements management; tools for identifying complex elements in projects; and organizational change management methods to prepare for transitioning the project outputs into the organization. TAILORING CONSIDERATIONS Because each project is unique, the project manager may need to tailor the way that Project Integration Management processes are applied. Considerations for tailoring include but are not limited to: Project life cycle. What is an appropriate project life cycle? What phases should comprise the project life cycle? Development life cycle. What development life cycle and approach are appropriate for the product, service, or result? Is a predictive or adaptive approach appropriate? If adaptive, should the product be developed incrementally or iteratively? Is a hybrid approach best? Management approaches. What management processes are most effective based on the organizational culture and the complexity of the project? Knowledge management. How will knowledge be managed in the project to foster a collaborative working environment? Change. How will change be managed in the project? Governance. What control boards, committees, and other stakeholders are part of the project? What are the project status reporting requirements? Lessons learned. What information should be collected throughout and at the end of the project? How will historical information and lessons learned be made available to future projects? Benefits. When and how should benefits be reported: at the end of the project or at the end of each iteration or phase? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
  • 116.
    Iterative and agileapproaches promote the engagement of team members as local domain experts in integration management. The team members determine how plans and components should integrate. The expectations of the project manager as noted in the Key Concepts for Integration Management do not change in an adaptive environment, but control of the detailed product planning and delivery is delegated to the team. The project manager's focus is on building a collaborative decision-making environment and ensuring the team has the ability to respond to changes. This collaborative approach can be further enhanced when team members possess a broad skill base rather than a narrow specialization. 4.1 DEVELOP PROJECT CHARTER Develop Project Charter is the process of developing a document that formally authorizes the existence of a project and provides the project manager with the authority to apply organizational resources to project activities. The key benefits of this process are that it provides a direct link between the project and the strategic objectives of the organization, creates a formal record of the project, and shows the organizational commitment to the project. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-2. Figure 4-3 depicts the data flow diagram for the process.
  • 117.
    The project charterestablishes a partnership between the performing and requesting organizations. In the case of external projects, a formal contract is typically the preferred way to establish an agreement. A project charter may still be used to establish internal agreements within an organization to ensure proper delivery under the contract. The approved project charter formally initiates the project. A project manager is identified and assigned as early in the project as is feasible, preferably while the project charter is being developed and always prior to the start of planning. The project charter can be developed by the sponsor or the project manager in collaboration with the initiating entity. This collaboration allows the project manager to have a better understanding of the project purpose, objectives, and expected benefits. This understanding will better allow for efficient resource allocation to project activities. The project charter provides the project manager with the authority to plan, execute, and control the project. Projects are initiated by an entity external to the project such as a sponsor, program, or project management office (PMO), or a portfolio governing body chairperson or authorized representative. The project initiator or sponsor should
  • 118.
    be at alevel that is appropriate to procure funding and commit resources to the project. Projects are initiated due to internal business needs or external influences. These needs or influences often trigger the creation of a needs analysis, feasibility study, business case, or description of the situation that the project will address. Chartering a project validates alignment of the project to the strategy and ongoing work of the organization. A project charter is not considered to be a contract because there is no consideration or money promised or exchanged in its creation. 4.1.1 DEVELOP PROJECT CHARTER: INPUTS 4.1.1.1 BUSINESS DOCUMENTS The business case (described in Section 1.2.6.1) and the benefits management plan (described in Section 1.2.6.2) are sources of information about the project´s objectives and how the project will contribute to the business goals. Although the business documents are developed prior to the project, they are reviewed periodically. Business case. The approved business case, or similar, is the business document most commonly used to create the project charter. The business case describes the necessary information from a business standpoint to determine whether the expected outcomes of the project justify the required investment. It is commonly used for decision making by managers or executives above the project level. Typically, the business need and the cost-benefit analysis are contained in the business case to justify and establish boundaries for the project. For more information on the business case, see Section 1.2.6.1. The business case is created as a result of one or more of the following: Market demand (e.g., an automobile manufacturer authorizing a project to build more fuel-efficient cars in response to gasoline shortages), Organizational need (e.g., due to high overhead costs, a company may combine staff functions and streamline processes to reduce costs), Customer request (e.g., an electric utility authorizing a project to build a new substation to serve a new industrial park),
  • 119.
    Technological advance (e.g.,an airline authorizing a new project to develop electronic tickets instead of paper tickets based on technological advances), Legal requirement (e.g., a paint manufacturer authorizing a project to establish guidelines for handling toxic materials), Ecological impacts (e.g., a company authorizing a project to lessen its environmental impact), or Social need (e.g., a nongovernmental organization in a developing country authorizing a project to provide potable water systems, latrines, and sanitation education to communities suffering from high rates of cholera). The project charter incorporates the appropriate information for the project from the business documents. The project manager does not update or modify the business documents since they are not project documents; however, the project manager may make recommendations. 4.1.1.2 AGREEMENTS Described in Section 12.2.3.2. Agreements are used to define initial intentions for a project. Agreements may take the form of contracts, memorandums of understanding (MOUs), service level agreements (SLA), letters of agreement, letters of intent, verbal agreements, email, or other written agreements. Typically, a contract is used when a project is being performed for an external customer. 4.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Develop Project Charter process include but are not limited to: Government or industry standards (e.g., product standards, quality standards, safety standards, and workmanship standards), Legal and regulatory requirements and/or constraints, Marketplace conditions, Organizational culture and political climate, Organizational governance framework (a structured way to provide control, direction, and coordination through people, policies, and
  • 120.
    processes to meetorganizational strategic and operational goals), and Stakeholders’ expectations and risk thresholds. 4.1.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Develop Project Charter process include but are not limited to: Organizational standard policies, processes, and procedures; Portfolio, program, and project governance framework (governance functions and processes to provide guidance and decision making); Monitoring and reporting methods; Templates (e.g., project charter template); and Historical information and lessons learned repository (e.g., project records and documents, information about the results of previous project selection decisions, and information about previous project performance). 4.1.2 DEVELOP PROJECT CHARTER: TOOLS AND TECHNIQUES 4.1.2.1 EXPERT JUDGMENT Expert judgment is defined as judgment provided based upon expertise in an application area, Knowledge Area, discipline, industry, etc., as appropriate for the activity being performed. Such expertise may be provided by any group or person with specialized education, knowledge, skill, experience, or training. For this process, expertise should be considered from individuals or groups with specialized knowledge of or training in the following topics: Organizational strategy, Benefits management, Technical knowledge of the industry and focus area of the project, Duration and budget estimation, and Risk identification.
  • 121.
    4.1.2.2 DATA GATHERING Data-gatheringtechniques that can be used for this process include but are not limited to: Brainstorming. This technique is used to identify a list of ideas in a short period of time. It is conducted in a group environment and is led by a facilitator. Brainstorming comprises two parts: idea generation and analysis. Brainstorming can be used to gather data and solutions or ideas from stakeholders, subject matter experts, and team members when developing the project charter. Focus groups. Described in Section 5.2.2.2. Focus groups bring together stakeholders and subject matter experts to learn about the perceived project risk, success criteria, and other topics in a more conversational way than a one-on-one interview. Interviews. Described in Section 5.2.2.2. Interviews are used to obtain information on high-level requirements, assumptions or constraints, approval criteria, and other information from stakeholders by talking directly to them. 4.1.2.3 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Conflict management. Described in Section 9.5.2.1. Conflict management can be used to help bring stakeholders into alignment on the objectives, success criteria, high-level requirements, project description, summary milestones, and other elements of the charter. Facilitation. Facilitation is the ability to effectively guide a group event to a successful decision, solution, or conclusion. A facilitator ensures that there is effective participation, that participants achieve a mutual understanding, that all contributions are considered, that conclusions or results have full buy-in according to the decision process established for the project, and that the actions and agreements achieved are appropriately dealt with afterward. Meeting management. Described in Section 10.2.2.6. Meeting management includes preparing the agenda, ensuring that a representative for each key stakeholder group is invited, and preparing
  • 122.
    and sending thefollow-up minutes and actions. 4.1.2.4 MEETINGS For this process, meetings are held with key stakeholders to identify the project objectives, success criteria, key deliverables, high-level requirements, summary milestones, and other summary information. 4.1.3 DEVELOP PROJECT CHARTER: OUTPUTS 4.1.3.1 PROJECT CHARTER The project charter is the document issued by the project initiator or sponsor that formally authorizes the existence of a project and provides the project manager with the authority to apply organizational resources to project activities. It documents the high-level information on the project and on the product, service, or result the project is intended to satisfy, such as: Project purpose; Measurable project objectives and related success criteria; High-level requirements; High-level project description, boundaries, and key deliverables; Overall project risk; Summary milestone schedule; Preapproved financial resources; Key stakeholder list; Project approval requirements (i.e., what constitutes project success, who decides the project is successful, and who signs off on the project); Project exit criteria (i.e., what are the conditions to be met in order to close or to cancel the project or phase); Assigned project manager, responsibility, and authority level; and Name and authority of the sponsor or other person(s) authorizing the project charter. At a high level, the project charter ensures a common understanding by the
  • 123.
    stakeholders of thekey deliverables, milestones, and the roles and responsibilities of everyone involved in the project. 4.1.3.2 ASSUMPTION LOG High-level strategic and operational assumptions and constraints are normally identified in the business case before the project is initiated and will flow into the project charter. Lower-level activity and task assumptions are generated throughout the project such as defining technical specifications, estimates, the schedule, risks, etc. The assumption log is used to record all assumptions and constraints throughout the project life cycle. 4.2 DEVELOP PROJECT MANAGEMENT PLAN Develop Project Management Plan is the process of defining, preparing, and coordinating all plan components and consolidating them into an integrated project management plan. The key benefit of this process is the production of a comprehensive document that defines the basis of all project work and how the work will be performed. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-4. Figure 4-5 depicts the data flow diagram for the process.
  • 124.
    The project managementplan defines how the project is executed, monitored and controlled, and closed. The project management plan's content varies depending on the application area and complexity of the project. The project management plan may be either summary level or detailed. Each component plan is described to the extent required by the specific project. The project management plan should be robust enough to respond to an ever- changing project environment. This agility may result in more accurate information as the project progresses. The project management plan should be baselined; that is, it is necessary to define at least the project references for scope, time, and cost, so that the project execution can be measured and compared to those references and performance can be managed. Before the baselines are defined, the project management plan may be updated as many times as necessary. No formal process is required at that time. But, once it is baselined, it may only be changed through the Perform Integrated Change Control process. Consequently, change requests will be generated and decided upon whenever a change is requested. This results in a project management plan that is progressively elaborated by controlled and approved updates extending through project closure. Projects that exist in the context of a program or portfolio should develop a project management plan that is consistent with the program or portfolio management plan. For example, if the program management plan indicates all
  • 125.
    changes exceeding aspecified cost need to be reviewed by the change control board (CCB), then this process and cost threshold need to be defined in the project management plan. 4.2.1 DEVELOP PROJECT MANAGEMENT PLAN: INPUTS 4.2.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project team uses the project charter as a starting point for initial project planning. The type and amount of information in the project charter varies depending on the complexity of the project and the information known at the time of its creation. At a minimum, the project charter should define the high-level information about the project that will be elaborated in the various components of the project management plan. 4.2.1.2 OUTPUTS FROM OTHER PROCESSES Outputs from many of the other processes described in Sections 5 through 13 are integrated to create the project management plan. Subsidiary plans and baselines that are an output from other planning processes are inputs to this process. In addition, changes to these documents may necessitate updates to the project management plan. 4.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Develop Project Management Plan process include but are not limited to: Government or industry standards (e.g., product standards, quality standards, safety standards, and workmanship standards); Legal and regulatory requirements and/or constraints; Project management body of knowledge for vertical market (e.g., construction) and/or focus area (e.g., environmental, safety, risk, or agile software development); Organizational structure, culture, management practices, and sustainability; Organizational governance framework (a structured way to provide control, direction, and coordination through people, policies, and
  • 126.
    processes to meetorganizational strategic and operational goals); and Infrastructure (e.g., existing facilities and capital equipment). 4.2.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Develop Project Management Plan process include but are not limited to: Organizational standard policies, processes, and procedures; Project management plan template, including: Guidelines and criteria for tailoring the organization's set of standard processes to satisfy the specific needs of the project, and Project closure guidelines or requirements such as the product validation and acceptance criteria. Change control procedures, including the steps by which official organizational standards, policies, plans, procedures, or any project documents will be modified and how any changes will be approved and validated; Monitoring and reporting methods, risk control procedures, and communication requirements; Project information from previous similar projects (e.g., scope, cost, schedule and performance measurement baselines, project calendars, project schedule network diagrams, and risk registers); and Historical information and lessons learned repository. 4.2.2 DEVELOP PROJECT MANAGEMENT PLAN: TOOLS AND TECHNIQUES 4.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge of or training in the following topics: Tailoring the project management process to meet the project needs, including the dependencies and interactions among those processes and the essential inputs and outputs;
  • 127.
    Developing additional componentsof the project management plan if needed; Determining the tools and techniques to be used for accomplishing those processes; Developing technical and management details to be included in the project management plan; Determining resources and skill levels needed to perform project work; Defining the level of configuration management to apply on the project; Determining which project documents will be subject to the formal change control process; and Prioritizing the work on the project to ensure the project resources are allocated to the appropriate work at the appropriate time. 4.2.2.2 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to: Brainstorming. Described in Section 4.1.2.2. Brainstorming is frequently used when developing the project management plan to gather ideas and solutions about the project approach. Attendees include the project team members although other subject matter experts (SMEs) or stakeholders may also participate. Checklists. Described in Section 11.2.2.2. Many organizations have standardized checklists available based in their own experience or use checklists from the industry. A checklist may guide the project manager to develop the plan or may help to verify that all the required information is included in the project management plan. Focus groups. Described in Section 5.2.2.2. Focus groups bring together stakeholders to discuss the project management approach and the integration of the different components of the project management plan. Interviews. Described in Section 5.2.2.2. Interviews are used to obtain specific information from stakeholders to develop the project
  • 128.
    management plan orany component plan or project document. 4.2.2.3 INTERPERSONAL AND TEAM SKILLS The interpersonal and team skills used when developing the project management plan include: Conflict management. Described in Section 9.5.2.1. Conflict management may be necessary to bring diverse stakeholders into alignment on all aspects of the project management plan. Facilitation. Described in Section 4.1.2.3. Facilitation ensures that there is effective participation, that participants achieve a mutual understanding, that all contributions are considered, and that conclusions or results have full buy-in according to the decision process established for the project. Meeting management. Described in Section 10.2.2.6. Meeting management is necessary to ensure that the numerous meetings that are necessary to develop, unify, and agree on the project management plan are well run. 4.2.2.4 MEETINGS For this process, meetings are used to discuss the project approach, determine how work will be executed to accomplish the project objectives, and establish the way the project will be monitored and controlled. The project kick-off meeting is usually associated with the end of planning and the start of executing. Its purpose is to communicate the objectives of the project, gain the commitment of the team for the project, and explain the roles and responsibilities of each stakeholder. The kick-off may occur at different points in time depending on the characteristics of the project: For small projects, there is usually only one team that performs the planning and the execution. In this case, the kick-off occurs shortly after initiation, in the Planning Process Group, because the team is involved in planning. In large projects, a project management team normally does the majority of the planning, and the remainder of the project team is brought on when the initial planning is complete, at the start of the development/implementation. In this instance, the kick-off meeting
  • 129.
    takes place withprocesses in the Executing Process Group. Multiphase projects will typically include a kick-off meeting at the beginning of each phase. 4.2.3 DEVELOP PROJECT MANAGEMENT PLAN: OUTPUTS 4.2.3.1 PROJECT MANAGEMENT PLAN The project management plan is the document that describes how the project will be executed, monitored and controlled, and closed. It integrates and consolidates all of the subsidiary management plans and baselines, and other information necessary to manage the project. The needs of the project determine which components of the project management plan are needed. Project management plan components include but are not limited to: Subsidiary management plans: Scope management plan. Described in Section 5.1.3.1. Establishes how the scope will be defined, developed, monitored, controlled, and validated. Requirements management plan. Described in Section 5.1.3.2. Establishes how the requirements will be analyzed, documented, and managed. Schedule management plan. Described in Section 6.1.3.1. Establishes the criteria and the activities for developing, monitoring, and controlling the schedule. Cost management plan. Described in Section 7.1.3.1. Establishes how the costs will be planned, structured, and controlled. Quality management plan. Described in Section 8.1.3.1. Establishes how an organization´s quality policies, methodologies, and standards will be implemented in the project. Resource management plan. Described in Section 9.1.3.1 Provides guidance on how project resources should be categorized, allocated, managed, and released. Communications management plan. Described in Section 10.1.3.1. Establishes how, when, and by whom information about the project will be administered and disseminated.
  • 130.
    Risk management plan.Described in Section 11.1.3.1. Establishes how the risk management activities will be structured and performed. Procurement management plan. Described in Section 12.1.3.1. Establishes how the project team will acquire goods and services from outside of the performing organization. Stakeholder engagement plan. Described in Section 13.2.3.1. Establishes how stakeholders will be engaged in project decisions and execution, according to their needs, interests, and impact. Baselines: Scope baseline. Described in Section 5.4.3.1. The approved version of a scope statement, work breakdown structure (WBS), and its associated WBS dictionary, which is used as a basis for comparison. Schedule baseline. Described in Section 6.5.3.1. The approved version of the schedule model that is used as a basis for comparison to the actual results. Cost baseline. Described in Section 7.3.3.1. The approved version of the time-phased project budget that is used as a basis for comparison to the actual results. Additional components. Most components of the project management plan are produced as outputs from other processes, though some are produced during this process. Those components developed as part of this process will be dependent on the project; however, they often include but are not limited to: Change management plan. Describes how the change requests throughout the project will be formally authorized and incorporated. Configuration management plan. Describes how the information about the items of the project (and which items) will be recorded and updated so that the product, service, or result of the project remains consistent and/or operative. Performance measurement baseline. An integrated scope-schedule- cost plan for the project work against which project execution is compared to measure and manage performance. Project life cycle. Describes the series of phases that a project passes through from its initiation to its closure.
  • 131.
    Development approach. Describesthe product, service, or result development approach, such as predictive, iterative, agile, or a hybrid model. Management reviews. Identifies the points in the project when the project manager and relevant stakeholders will review the project progress to determine if performance is as expected, or if preventive or corrective actions are necessary. While the project management plan is one of the primary documents used to manage the project, other project documents are also used. These other documents are not part of the project management plan; however, they are necessary to manage the project effectively. Table 4-1 is a representative list of the project management plan components and project documents. Table 4-1. Project Management Plan and Project Documents Project Management Plan Project Documents 1. Scope management plan 1. Activity attributes 19. Quality control measurements 2. Requirements management plan 2. Activity list 20. Quality metrics 3. Schedule management plan 3. Assumption log 21. Quality report 4. Cost management plan 4. Basis of estimates 22. Requirements documentation 5. Quality management plan 5. Change log 23. Requirements traceability matrix 6. Resource management plan 6. Cost estimates 24. Resource breakdown structure 7. Communications management plan 7. Cost forecasts 25. Resource calendars 8. Risk management plan 8. Duration estimates 26. Resource requirements 9. Procurement management plan 9. Issue log 27. Risk register 10. Stakeholder engagement plan 10. Lessons learned register 28. Risk report 11. Change management plan 11. Milestone list 29. Schedule data 12. Configuration management plan 12. Physical resource assignments 30. Schedule forecasts 13. Scope baseline 13. Project calendars 31. Stakeholder register
  • 132.
    14. Schedule baseline14. Project communications 32. Team charter 15. Cost baseline 15. Project schedule 33. Test and evaluation documents 16. Performance measurement baseline 16. Project schedule network diagram 17. Project life cycle description 17. Project scope statement 18. Development approach 18. Project team assignments 4.3 DIRECT AND MANAGE PROJECT WORK Direct and Manage Project Work is the process of leading and performing the work defined in the project management plan and implementing approved changes to achieve the project's objectives. The key benefit of this process is that it provides overall management of the project work and deliverables, thus improving the probability of project success. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-6. Figure 4-7 depicts the data flow diagram for the process.
  • 133.
    Direct and ManageProject Work involves executing the planned project activities to complete project deliverables and accomplish established objectives. Available resources are allocated, their efficient use is managed, and changes in project plans stemming from analyzing work performance data and information are carried out. The Direct and Manage Project Work process is directly affected by the project application area. Deliverables are produced as outputs from processes performed to accomplish the project work as planned and scheduled in the project management plan. The project manager, along with the project management team, directs the performance of the planned project activities and manages the various technical and organizational interfaces that exist in the project. Direct and Manage Project Work also requires review of the impact of all project changes and the
  • 134.
    implementation of approvedchanges: corrective action, preventive action, and/or defect repair. During project execution, the work performance data is collected and communicated to the applicable controlling processes for analysis. Work performance data analysis provides information about the completion status of deliverables and other relevant details about project performance. The work performance data will also be used as an input to the Monitoring and Controlling Process Group, and can be used as feedback into lessons learned to improve the performance of future work packages. 4.3.1 DIRECT AND MANAGE PROJECT WORK: INPUTS 4.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Any component of the project management plan may be an input to this process. 4.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Change log. Described in Section 4.6.3.3. The change log contains the status of all change requests. Lessons learned register. Described in Section 4.4.3.1. Lessons learned are used to improve the performance of the project and to avoid repeating mistakes. The register helps identify where to set rules or guidelines so the team's actions are aligned. Milestone list. Described in Section 6.2.3.3. The milestone list shows the scheduled dates for specific milestones. Project communications. Described in Section 10.2.3.1. Project communications include performance reports, deliverable status, and other information generated by the project. Project schedule. Described in Section 6.5.3.2. The schedule includes at least the list of work activities, their durations, resources, and planned start and finish dates. Requirements traceability matrix. Described in Section 5.2.3.2. The
  • 135.
    requirements traceability matrixlinks product requirements to the deliverables that satisfy them and helps to focus on the final outcomes. Risk register. Described in Section 11.2.3.1. The risk register provides information on threats and opportunities that may impact project execution. Risk report. Described in Section 11.2.3.2. The risk report provides information on sources of overall project risk along with summary information on identified individual project risks. 4.3.1.3 APPROVED CHANGE REQUESTS Described in Section 4.6.3.1. Approved change requests are an output of the Perform Integrated Change Control process, and include those requests reviewed and approved for implementation by the project manager or by the change control board (CCB) when applicable. The approved change request may be a corrective action, a preventive action, or a defect repair. Approved change requests are scheduled and implemented by the project team and can impact any area of the project or project management plan. The approved change requests can also modify the formally controlled project management plan components or project documents. 4.3.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Direct and Manage Project Work process include but are not limited to: Organizational structure, culture, management practices, and sustainability; Infrastructure (e.g., existing facilities and capital equipment); and Stakeholder risk thresholds (e.g., allowable cost overrun percentage). 4.3.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Direct and Manage Project Work process include but are not limited to: Organizational standard policies, processes, and procedures; Issue and defect management procedures defining issue and defect controls, issue and defect identification and resolution, and action item
  • 136.
    tracking; Issue and defectmanagement database(s) containing historical issue and defect status, issue and defect resolution, and action item results; Performance measurement database used to collect and make available measurement data on processes and products; Change control and risk control procedures; and Project information from previous projects (e.g., scope, cost, schedule, performance measurement baselines, project calendars, project schedule network diagrams, risk registers, risk reports, and lessons learned repository). 4.3.2 DIRECT AND MANAGE PROJECT WORK: TOOLS AND TECHNIQUES 4.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Technical knowledge on the industry and focus area of the project, Cost and budget management, Legal and procurement, Legislation and regulations, and Organizational governance. 4.3.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) The PMIS provides access to information technology (IT) software tools, such as scheduling software tools, work authorization systems, configuration management systems, information collection and distribution systems, as well as interfaces to other online automated systems such as corporate knowledge base repositories. Automated gathering and reporting on key performance indicators (KPI) can be part of this system. 4.3.2.3 MEETINGS Meetings are used to discuss and address pertinent topics of the project when
  • 137.
    directing and managingproject work. Attendees may include the project manager, the project team, and appropriate stakeholders involved or affected by the topics addressed. Each attendee should have a defined role to ensure appropriate participation. Types of meetings include but are not limited to: kick- off, technical, sprint or iteration planning, Scrum daily standups, steering group, problem solving, progress update, and retrospective meetings. 4.3.3 DIRECT AND MANAGE PROJECT WORK: OUTPUTS 4.3.3.1 DELIVERABLES A deliverable is any unique and verifiable product, result, or capability to perform a service that is required to be produced to complete a process, phase, or project. Deliverables are typically the outcomes of the project and can include components of the project management plan. Change control should be applied once the first version of a deliverable has been completed. The control of the multiple versions or editions of a deliverable (e.g., documents, software, and building blocks) is supported by configuration management tools and procedures. 4.3.3.2 WORK PERFORMANCE DATA Work performance data are the raw observations and measurements identified during activities being performed to carry out the project work. Data are often viewed as the lowest level of detail from which information is derived by other processes. Data is gathered through work execution and passed to the controlling processes for further analysis. Examples of work performance data include work completed, key performance indicators (KPIs), technical performance measures, actual start and finish dates of schedule activities, story points completed, deliverables status, schedule progress, number of change requests, number of defects, actual costs incurred, actual durations, etc. 4.3.3.3 ISSUE LOG Throughout the life cycle of a project, the project manager will normally face problems, gaps, inconsistencies, or conflicts that occur unexpectedly and that require some action so they do not impact the project performance. The issue log is a project document where all the issues are recorded and tracked. Data on
  • 138.
    issues may include: Issuetype, Who raised the issue and when, Description, Priority, Who is assigned to the issue, Target resolution date, Status, and Final solution. The issue log will help the project manager effectively track and manage issues, ensuring that they are investigated and resolved. The issue log is created for the first time as an output of this process, although issues may happen at any time during the project. The issue log is updated as a result of the monitoring and control activities throughout the project's life cycle. 4.3.3.4 CHANGE REQUESTS A change request is a formal proposal to modify any document, deliverable, or baseline. When issues are found while project work is being performed, change requests can be submitted, which may modify project policies or procedures, project or product scope, project cost or budget, project schedule, or quality of the project or product results. Other change requests cover the needed preventive or corrective actions to forestall negative impact later in the project. Any project stakeholder may request a change. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). Change requests can be initiated from inside or outside the project and they can be optional or legally/contractually mandated. Change requests may include: Corrective action. An intentional activity that realigns the performance of the project work with the project management plan. Preventive action. An intentional activity that ensures the future performance of the project work is aligned with the project management plan. Defect repair. An intentional activity to modify a nonconforming product or product component. Updates. Changes to formally controlled project documents, plans,
  • 139.
    etc., to reflectmodified or additional ideas or content. 4.3.3.5 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Any component of the project management plan may require a change request as a result of this process. 4.3.3.6 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Activity list. Described in Section 6.2.3.1. The activity list may be updated with additional or modified activities to be performed to complete project work. Assumption log. Described in Section 4.1.3.2. New assumptions and constraints may be added, and the status of existing assumptions and constraints may be updated or closed out. Lessons learned register. Described in Section 4.4.3.1. Any lessons learned that will improve performance for current or future projects is recorded as it is learned. Requirements documentation. Described in Section 5.2.3.1. New requirements may be identified during this process. Progress on meeting requirements can also be updated. Risk register. Described in Section 11.2.3.1. New risks may be identified and existing risks may be updated during this process. Risks are recorded in the risk register via risk management processes. Stakeholder register. Described in Section 13.1.3.1. Where additional information on existing or new stakeholders is gathered as a result of this process, it is recorded in the stakeholder register. 4.3.3.7 ORGANIZATIONAL PROCESS ASSETS UPDATES Any organizational process asset can be updated as a result of this process. 4.4 MANAGE PROJECT KNOWLEDGE
  • 140.
    Manage Project Knowledgeis the process of using existing knowledge and creating new knowledge to achieve the project's objectives and contribute to organizational learning. The key benefits of this process are that prior organizational knowledge is leveraged to produce or improve the project outcomes, and knowledge created by the project is available to support organizational operations and future projects or phases. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-8. Figure 4-9 depicts the data flow diagram for the process.
  • 141.
    Knowledge is commonlysplit into “explicit” (knowledge that can be readily codified using words, pictures, and numbers) and “tacit” (knowledge that is personal and difficult to express, such as beliefs, insights, experience, and “know-how”). Knowledge management is concerned with managing both tacit and explicit knowledge for two purposes: reusing existing knowledge and creating new knowledge. The key activities that underpin both purposes are knowledge sharing and knowledge integration (of knowledge from different domains, contextual knowledge, and project management knowledge). It is a common misconception that managing knowledge involves just documenting it so it can be shared. Another common misconception is that managing knowledge involves just obtaining lessons learned at the end of the project, in order to use it in the future projects. Only codified explicit knowledge can be shared in this way. But codified explicit knowledge lacks context and is open to different interpretations, so even though it can easily be shared, it isn't always understood or applied in the right way. Tacit knowledge has context built in but is very difficult to codify. It resides in the minds of individual experts or
  • 142.
    in social groupsand situations, and is normally shared through conversations and interactions between people. From an organizational perspective, knowledge management is about making sure the skills, experience, and expertise of the project team and other stakeholders are used before, during, and after the project. Because knowledge resides in the minds of people and people cannot be forced to share what they know (or to pay attention to others’ knowledge), the most important part of knowledge management is creating an atmosphere of trust so that people are motivated to share their knowledge. Even the best knowledge management tools and techniques will not work if people are not motivated to share what they know or to pay attention to what others know. In practice, knowledge is shared using a mixture of knowledge management tools and techniques (interactions between people) and information management tools and techniques (in which people codify part of their explicit knowledge by documenting it so it can be shared). 4.4.1 MANAGE PROJECT KNOWLEDGE: INPUTS 4.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. All components of the project management plan are inputs. 4.4.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register provides information on effective practices in knowledge management. Project team assignments. Described in Section 9.3.3.1. Project team assignments provide information on the type of competencies and experience available in the project and the knowledge that may be missing. Resource breakdown structure. Described in Section 9.2.3.3. The resource breakdown structure includes information on the composition of the team and may help to understand what knowledge is available as
  • 143.
    a group andwhat knowledge is missing. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register contains details about the identified stakeholders to help understand the knowledge they may have. 4.4.1.3 DELIVERABLES A deliverable is any unique and verifiable product, result, or capability to perform a service that is required to be produced to complete a process, phase, or project. Deliverables are typically tangible components completed to meet the project objectives and can include components of the project management plan. 4.4.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Manage Project Knowledge process include but are not limited to: Organizational, stakeholder, and customer culture. The existence of trusting working relationships and a no-blame culture is particularly important in managing knowledge. Other factors include the value placed on learning and social behavioral norms. Geographic distribution of facilities and resources. The location of team members helps determine methods for gaining and sharing knowledge. Organizational knowledge experts. Some organizations have a team or individual that specializes in knowledge management. Legal and regulatory requirements and/or constraints. These include confidentiality of project information. 4.4.1.5 ORGANIZATIONAL PROCESS ASSETS Knowledge about project management is often embedded in processes and routines. The organizational process assets that can influence the Manage Project Knowledge process include but are not limited to: Organizational standard policies, processes, and procedures. These may include: confidentiality and access to information; security and data protection; record retention policies; use of copyrighted information; destruction of classified information; format and maximum size of files; registry data and metadata; authorized
  • 144.
    technology and socialmedia; etc. Personnel administration. These include, for example, employee development and training records, and competency frameworks that refer to knowledge-sharing behaviors. Organizational communication requirements. Formal, rigid communication requirements are good for sharing information. Informal communication is more effective for creating new knowledge and integrating knowledge across diverse stakeholder groups. Formal knowledge-sharing and information-sharing procedures. These include learning reviews before, during, and after projects and project phases; for example, identifying, capturing, and sharing lessons learned from the current project and other projects. 4.4.2 MANAGE PROJECT KNOWLEDGE: TOOLS AND TECHNIQUES 4.4.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Knowledge management, Information management, Organizational learning, Knowledge and information management tools, and Relevant information from other projects. 4.4.2.2 KNOWLEDGE MANAGEMENT Knowledge management tools and techniques connect people so they can work together to create new knowledge, share tacit knowledge, and integrate the knowledge of diverse team members. The tools and techniques appropriate in a project depend on the nature of the project, especially the degree of innovation involved, the project complexity, and the level of diversity (including diversity of disciplines) among team members. Tools and techniques include but are not limited to:
  • 145.
    Networking, including informalsocial interaction and online social networking. Online forums where people can ask open questions (“What does anyone know about…?”) are useful for starting knowledge-sharing conversations with specialists; Communities of practice (sometimes called communities of interest or just communities) and special interest groups; Meetings, including virtual meetings where participants can interact using communications technology; Work shadowing and reverse shadowing; Discussion forums such as focus groups; Knowledge-sharing events such as seminars and conferences; Workshops, including problem-solving sessions and learning reviews designed to identify lessons learned; Storytelling; Creativity and ideas management techniques; Knowledge fairs and cafés; and Training that involves interaction between learners. All of these tools and techniques can be applied face-to-face or virtually, or both. Face-to-face interaction is usually the most effective way to build the trusting relationships that are needed to manage knowledge. Once relationships are established, virtual interaction can be used to maintain the relationship. 4.4.2.3 INFORMATION MANAGEMENT Information management tools and techniques are used to create and connect people to information. They are effective for sharing simple, unambiguous, codified explicit knowledge. They include but are not limited to: Methods for codifying explicit knowledge; for example, for producing lessons to be learned entries for the lessons learned register; Lessons learned register; Library services; Information gathering, for example, web searches and reading published articles; and Project management information system (PMIS). Described in Section
  • 146.
    4.3.2.2. Project managementinformation systems often include document management systems. Tools and techniques that connect people to information can be enhanced by adding an element of interaction, for example, include a “contact me” function so users can get in touch with the originators of the lessons and ask for advice specific to their project and context. Interaction and support also helps people find relevant information. Asking for help is generally quicker and easier than trying to identify search terms. Search terms are often difficult to select because people may not know which keywords or key phrases to use to access the information they need. Knowledge and information management tools and techniques should be connected to project processes and process owners. Communities of practice and subject matter experts (SMEs), for example, may generate insights that lead to improved control processes; having an internal sponsor can ensure improvements are implemented. Lessons learned register entries may be analyzed to identify common issues that can be addressed by changes to project procedures. 4.4.2.4 INTERPERSONAL AND TEAM SKILLS The interpersonal and team skills used include but are not limited to: Active listening. Described in Section 10.2.2.6. Active listening helps reduce misunderstandings and improves communication and knowledge sharing. Facilitation. Described in Section 4.1.2.3. Facilitation helps effectively guide a group to a successful decision, solution, or conclusion. Leadership. Described in Section 3.4.4. Leadership is used to communicate the vision and inspire the project team to focus on the appropriate knowledge and knowledge objectives. Networking. Described in Section 10.2.2.6. Networking allows informal connections and relations among project stakeholders to be established and creates the conditions to share tacit and explicit knowledge. Political awareness. Described in Section 10.1.2.6. Political awareness helps the project manager to plan communications based on the project environment as well as the organization's political environment.
  • 147.
    4.4.3 MANAGE PROJECTKNOWLEDGE: OUTPUTS 4.4.3.1 LESSONS LEARNED REGISTER The lessons learned register can include the category and description of the situation. The lessons learned register may also include the impact, recommendations, and proposed actions associated with the situation. The lessons learned register may record challenges, problems, realized risks and opportunities, or other content as appropriate. The lessons learned register is created as an output of this process early in the project. Thereafter it is used as an input and updated as an output in many processes throughout the project. The persons or teams involved in the work are also involved in capturing the lessons learned. Knowledge can be documented using videos, pictures, audios, or other suitable means that ensure the efficiency of the lessons captured. At the end of a project or phase, the information is transferred to an organizational process asset called a lessons learned repository. 4.4.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Any component of the project management plan may be updated as a result of this process. 4.4.3.3 ORGANIZATIONAL PROCESS ASSETS UPDATES All projects create new knowledge. Some of this knowledge is codified, embedded in deliverables, or embedded in improvements to processes and procedures as a result of the Manage Project Knowledge process. Existing knowledge can also be codified or embedded for the first time as a result of this process; for example, if an existing idea for a new procedure is piloted in the project and found to be successful. Any organizational process asset can be updated as a result of this process. 4.5 MONITOR AND CONTROL PROJECT WORK Monitor and Control Project Work is the process of tracking, reviewing, and reporting the overall progress to meet the performance objectives defined in the
  • 148.
    project management plan.The key benefits of this process are that it allows stakeholders to understand the current state of the project, to recognize the actions taken to address any performance issues, and to have visibility into the future project status with cost and schedule forecasts. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-10. Figure 4-11 depicts the data flow diagram for the process.
  • 149.
    Monitoring is anaspect of project management performed throughout the project. Monitoring includes collecting, measuring, and assessing measurements and trends to effect process improvements. Continuous monitoring gives the project management team insight into the health of the project and identifies any areas that may require special attention. Control includes determining corrective or preventive actions or replanning and following up on action plans to determine whether the actions taken resolved the performance issue. The Monitor and Control Project Work process is concerned with: Comparing actual project performance against the project management plan;
  • 150.
    Assessing performance periodicallyto determine whether any corrective or preventive actions are indicated, and then recommending those actions as necessary; Checking the status of individual project risks; Maintaining an accurate, timely information base concerning the project's product(s) and their associated documentation through project completion; Providing information to support status reporting, progress measurement, and forecasting; Providing forecasts to update current cost and current schedule information; Monitoring implementation of approved changes as they occur; Providing appropriate reporting on project progress and status to program management when the project is part of an overall program; and Ensuring that the project stays aligned with the business needs. 4.5.1 MONITOR AND CONTROL PROJECT WORK: INPUTS 4.5.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Monitoring and controlling project work involves looking at all aspects of the project. Any component of the project management plan may be an input for this process. 4.5.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log contains information about assumptions and constraints identified as affecting the project. Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. Basis of estimates indicates how the various estimates were derived and can be used to make a decision on how to respond to variances.
  • 151.
    Cost forecasts. Describedin Section 7.4.3.2. Based on the project's past performance, the cost forecasts are used to determine if the project is within defined tolerance ranges for budget and to identify any necessary change requests. Issue log. Described in Section 4.3.3.3. The issue log is used to document and monitor who is responsible for resolving specific issues by a target date. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register may have information on effective responses for variances, and corrective and preventive actions. Milestone list. Described in Section 6.2.3.3. The milestone list shows the scheduled dates for specific milestones and is used to check if the planned milestones have been met. Quality reports. Described in Section 8.2.3.1. The quality report includes quality management issues; recommendations for process, project, and product improvements; corrective actions recommendations (includes rework, defect/bugs repair, 100% inspection, and more); and the summary of findings from the Control Quality process. Risk register. Described in Section 11.2.3.1. The risk register provides information on threats and opportunities that have occurred during project execution. Risk report. Described in Section 11.2.3.2. The risk report provides information on the overall project risks as well as information on specified individual risks. Schedule forecasts. Described in Section 6.6.3.2. Based on the project's past performance, the schedule forecasts are used to determine if the project is within defined tolerance ranges for schedule and to identify any necessary change requests. 4.5.1.3 WORK PERFORMANCE INFORMATION Work performance data is gathered through work execution and passed to the controlling processes. To become work performance information, the work performance data are compared with the project management plan components, project documents, and other project variables. This comparison indicates how the project is performing.
  • 152.
    Specific work performancemetrics for scope, schedule, budget, and quality are defined at the start of the project as part of the project management plan. Performance data are collected during the project through the controlling processes and compared to the plan and other variables to provide a context for work performance. For example, work performance data on cost may include funds that have been expended. However, to be useful, that data has to be compared to the budget, the work that was performed, the resources used to accomplish the work, and the funding schedule. This additional information provides the context to determine if the project is on budget or if there is a variance. It also indicates the degree of variance from the plan, and by comparing it to the variance thresholds in the project management plan it can indicate if preventive or corrective action is required. Interpreting work performance data and the additional information as a whole provides a context that provides a sound foundation for project decisions. 4.5.1.4 AGREEMENTS Described in Section 12.2.3.2. A procurement agreement includes terms and conditions, and may incorporate other items that the buyer specifies regarding what the seller is to perform or provide. If the project is outsourcing part of the work, the project manager needs to oversee the contractor's work to make certain that all the agreements meet the specific needs of the project while adhering to organizational procurement policies. 4.5.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Monitor and Control Project Work process include but are not limited to: Project management information systems such as scheduling, cost, resourcing tools, performance indicators, databases, project records, and financials; Infrastructure (e.g., existing facilities and equipment, organization´s telecommunications channels); Stakeholders’ expectations and risk thresholds; and Government or industry standards (e.g., regulatory agency regulations, product standards, quality standards, and workmanship standards).
  • 153.
    4.5.1.6 ORGANIZATIONAL PROCESSASSETS The organizational process assets that can influence the Monitor and Control Project Work process include but are not limited to: Organizational standard policies, processes, and procedures; Financial controls procedures (e.g., required expenditure and disbursement reviews, accounting codes, and standard contract provisions); Monitoring and reporting methods; Issue management procedures defining issue controls, issue identification, and resolution and action item tracking; Defect management procedures defining defect controls, defect identification, and resolution and action item tracking; and Organizational knowledge base, in particular process measurement and the lessons learned repository. 4.5.2 MONITOR AND CONTROL PROJECT WORK: TOOLS AND TECHNIQUES 4.5.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Earned value analysis, Interpretation and contextualization of data, Techniques to estimate duration and costs, Trend analysis, Technical knowledge on the industry and focus area of the project, Risk management, and Contract management. 4.5.2.2 DATA ANALYSIS Data analysis techniques that can be used include but are not limited to:
  • 154.
    Alternatives analysis. Alternativesanalysis is used to select the corrective actions or a combination of corrective and preventive actions to implement when a deviation occurs. Cost-benefit analysis. Described in Section 8.1.2.3. Cost-benefit analysis helps to determine the best corrective action in terms of cost in case of project deviations. Earned value analysis. Described in Section 7.4.2.2. Earned value provides an integrated perspective on scope, schedule, and cost performance. Root cause analysis. Described in Section 8.2.2.2. Root cause analysis focuses on identifying the main reasons of a problem. It can be used to identify the reasons for a deviation and the areas the project manager should focus on in order to achieve the objectives of the project. Trend analysis. Trend analysis is used to forecast future performance based on past results. It looks ahead in the project for expected slippages and warns the project manager ahead of time that there may be problems later in the schedule if established trends persist. This information is made available early enough in the project timeline to give the project team time to analyze and correct any anomalies. The results of trend analysis can be used to recommend preventive actions if necessary. Variance analysis. Variance analysis reviews the differences (or variance) between planned and actual performance. This can include duration estimates, cost estimates, resources utilization, resources rates, technical performance, and other metrics. Variance analysis may be conducted in each Knowledge Area based on its particular variables. In Monitor and Control Project Work, the variance analysis reviews the variances from an integrated perspective considering cost, time, technical, and resource variances in relation to each other to get an overall view of variance on the project. This allows for the appropriate preventive or corrective actions to be initiated. 4.5.2.3 DECISION MAKING A decision-making technique that can be used includes but is not limited to voting. Described in Section 5.2.2.4. Voting can include making decisions based on unanimity, majority, or plurality.
  • 155.
    4.5.2.4 MEETINGS Meetings maybe face-to-face, virtual, formal, or informal. They may include project team members and other project stakeholders when appropriate. Types of meetings include but are not limited to user groups and review meetings. 4.5.3 MONITOR AND CONTROL PROJECT WORK: OUTPUTS 4.5.3.1 WORK PERFORMANCE REPORTS Work performance information is combined, recorded, and distributed in a physical or electronic form in order to create awareness and generate decisions or actions. Work performance reports are the physical or electronic representation of work performance information intended to generate decisions, actions, or awareness. They are circulated to the project stakeholders through the communication processes as defined in the project communications management plan. Examples of work performance reports include status reports and progress reports. Work performance reports can contain earned value graphs and information, trend lines and forecasts, reserve burndown charts, defect histograms, contract performance information, and risk summaries. They can be presented as dashboards, heat reports, stop light charts, or other representations useful for creating awareness and generating decisions and actions. 4.5.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. As a result of comparing planned results to actual results, change requests may be issued to expand, adjust, or reduce project scope, product scope, or quality requirements and schedule or cost baselines. Change requests may necessitate the collection and documentation of new requirements. Changes can impact the project management plan, project documents, or product deliverables. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). Changes may include but are not limited to: Corrective action. An intentional activity that realigns the performance of the project work with the project management plan. Preventive action. An intentional activity that ensures the future performance of the project work is aligned with the project
  • 156.
    management plan. Defect repair.An intentional activity that modifies a nonconforming product or product component. 4.5.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Changes identified during the Monitor and Control Project Work process may affect the overall project management plan. 4.5.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Cost forecasts. Described in Section 7.4.3.2. Changes in cost forecasts resulting from this process are recorded using cost management processes. Issue log. Described in Section 4.3.3.3. New issues raised as a result of this process are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with effective responses for variances and corrective and preventive actions. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. Schedule forecasts. Described in Section 6.6.3.2. Changes in schedule forecasts resulting from this process are recorded using schedule management processes. 4.6 PERFORM INTEGRATED CHANGE CONTROL Perform Integrated Change Control is the process of reviewing all change requests; approving changes and managing changes to deliverables, project documents, and the project management plan; and communicating the decisions. This process reviews all requests for changes to project documents, deliverables, or the project management plan and determines the resolution of the change
  • 157.
    requests. The keybenefit of this process is that it allows for documented changes within the project to be considered in an integrated manner while addressing overall project risk, which often arises from changes made without consideration of the overall project objectives or plans. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-12. Figure 4-13 depicts the data flow diagram for the process.
  • 158.
    The Perform IntegratedChange Control process is conducted from project start through completion and is the ultimate responsibility of the project manager. Change requests can impact the project scope and the product scope, as well as any project management plan component or any project document. Changes may be requested by any stakeholder involved with the project and may occur at any time throughout the project life cycle. The applied level of change control is dependent upon the application area, complexity of the specific project, contract requirements, and the context and environment in which the project is performed. Before the baselines are established, changes are not required to be formally controlled by the Perform Integrated Change Control process. Once the project is
  • 159.
    baselined, change requestsgo through this process. As a general rule, each project's configuration management plan should define which project artifacts need to be placed under configuration control. Any change in a configuration element should be formally controlled and will require a change request. Although changes may be initiated verbally, they should be recorded in written form and entered into the change management and/or configuration management system. Change requests may require information on estimated schedule impacts and estimated cost impacts prior to approval. Whenever a change request may impact any of the project baselines, a formal integrated change control process is always required. Every documented change request needs to be either approved, deferred, or rejected by a responsible individual, usually the project sponsor or project manager. The responsible individual will be identified in the project management plan or by organizational procedures. When required, the Perform Integrated Change Control process includes a change control board (CCB), which is a formally chartered group responsible for reviewing, evaluating, approving, deferring, or rejecting changes to the project and for recording and communicating such decisions. Approved change requests can require new or revised cost estimates, activity sequences, schedule dates, resource requirements, and/or analysis of risk response alternatives. These changes can require adjustments to the project management plan and other project documents. Customer or sponsor approval may be required for certain change requests after CCB approval, unless they are part of the CCB. 4.6.1 PERFORM INTEGRATED CHANGE CONTROL: INPUTS 4.6.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Change management plan. Described in Section 4.2.3.1. The change management plan provides the direction for managing the change control process and documents the roles and responsibilities of the change control board (CCB). Configuration management plan. Described in Section 4.2.3.1. The configuration management plan describes the configurable items of the project and identifies the items that will be recorded and updated so
  • 160.
    that the productof the project remains consistent and operable. Scope baseline. Described in Section 5.4.3.1. The scope baseline provides the project and product definition. Schedule baseline. Described in Section 6.5.3.1. The schedule baseline is used to assess the impact of the changes in the project schedule. Cost baseline. Described in Section 7.3.3.1. The cost baseline is used to assess the impact of the changes to the project cost. 4.6.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Basis of estimates. Described in Section 6.4.3.2. Basis of estimates indicate how the duration, cost, and resources estimates were derived and can be used to calculate the impact of the change in time, budget, and resources. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix helps assess the impact of the change on the project scope. Risk report. Described in Section 11.2.3.2. The risk report presents information on sources of overall and individual project risks involved by the change requested. 4.6.1.3 WORK PERFORMANCE REPORTS Described in Section 4.5.3.1. Work performance reports of particular interest to the Perform Integrated Change Control process include resource availability, schedule and cost data, earned value reports, and burnup or burndown charts. 4.6.1.4 CHANGE REQUESTS Many processes produce change requests as an output. Change requests (described in Section 4.3.3.4) may include corrective action, preventive action, defect repairs, as well as updates to formally controlled documents or deliverables to reflect modified or additional ideas or content. Changes may or may not impact the project baselines—sometimes only the performance against the baseline is affected. Decisions on those changes are usually made by the project manager.
  • 161.
    Change requests thathave an impact on the project baselines should normally include information about the cost of implementing the change, modifications in the scheduled dates, resource requirements, and risks. These changes should be approved by the CCB (if it exists) and by the customer or sponsor, unless they are part of the CCB. Only approved changes should be incorporated into a revised baseline. 4.6.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Perform Integrated Change Control process include but are not limited to: Legal restrictions, such as country or local regulations; Government or industry standards (e.g., product standards, quality standards, safety standards, and workmanship standards); Legal and regulatory requirements and/or constraints; Organizational governance framework (a structured way to provide control, direction, and coordination through people, policies, and processes to meet organizational strategic and operational goals); and Contracting and purchasing constraints. 4.6.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Perform Integrated Change Control process include but are not limited to: Change control procedures, including the steps by which organizational standards, policies, plans, procedures, or any project documents will be modified, and how any changes will be approved and validated; Procedures for approving and issuing change authorizations; and Configuration management knowledge base containing the versions and baselines of all official organizational standards, policies, procedures, and any project documents. 4.6.2 PERFORM INTEGRATED CHANGE CONTROL: TOOLS AND TECHNIQUES
  • 162.
    4.6.2.1 EXPERT JUDGMENT Describedin Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge of or training in the following topics: Technical knowledge of the industry and focus area of the project, Legislation and regulations, Legal and procurement, Configuration management, and Risk management. 4.6.2.2 CHANGE CONTROL TOOLS In order to facilitate configuration and change management, manual or automated tools may be used. Configuration control is focused on the specification of both the deliverables and the processes, while change control is focused on identifying, documenting, and approving or rejecting changes to the project documents, deliverables, or baselines. Tool selection should be based on the needs of the project stakeholders including organizational and environmental considerations and/or constraints. Tools should support the following configuration management activities: Identify configuration item. Identification and selection of a configuration item to provide the basis for which the product configuration is defined and verified, products and documents are labeled, changes are managed, and accountability is maintained. Record and report configuration item status. Information recording and reporting about each configuration item. Perform configuration item verification and audit. Configuration verification and configuration audits ensure that the composition of a project's configuration items is correct and that corresponding changes are registered, assessed, approved, tracked, and correctly implemented. This ensures that the functional requirements defined in the configuration documentation are met. Tools should support the following change management activities as well: Identify changes. Identifying and selecting a change item for processes or project documents.
  • 163.
    Document changes. Documentingthe change into a proper change request. Decide on changes. Reviewing the changes; approving, rejecting, deferring, or making any other decision about changes to the project documents, deliverables, or baselines. Track changes. Verifying that the changes are registered, assessed, approved, and tracked and communicating final results to stakeholders. Tools are also used to manage the change requests and the resulting decisions. Additional considerations should be made for communications to assist the change control board (CCB) members in their duties, as well as to distribute the decisions to the appropriate stakeholders. 4.6.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Alternatives analysis. Described in Section 9.2.2.5. This technique is used to assess the requested changes and decide which are accepted, rejected, or need to be modified to be finally accepted. Cost-benefit analysis. Described in Section 8.1.2.3. This analysis helps to determine if the requested change is worth its associated cost. 4.6.2.4 DECISION MAKING Decision-making techniques that can be used for this process include but are not limited to: Voting. Described in Section 5.2.2.4. Voting can take the form of unanimity, majority, or plurality to decide on whether to accept, defer, or reject change requests. Autocratic decision making. In this decision-making technique, one individual takes the responsibility for making the decision for the entire group. Multicriteria decision analysis. Described in Section 8.1.2.4. This technique uses a decision matrix to provide a systematic analytical approach to evaluate the requested changes according to a set of predefined criteria.
  • 164.
    4.6.2.5 MEETINGS Change controlmeetings are held with a change control board (CCB) that is responsible for meeting and reviewing the change requests and approving, rejecting, or deferring change requests. Most changes will have some sort of impact on time, cost, resources, or risks. Assessing the impact of the changes is an essential part of the meeting. Alternatives to the requested changes may also be discussed and proposed. Finally, the decision is communicated to the request owner or group. The CCB may also review configuration management activities. The roles and responsibilities of these boards are clearly defined and agreed upon by the appropriate stakeholders and are documented in the change management plan. CCB decisions are documented and communicated to the stakeholders for information and follow-up actions. 4.6.3 PERFORM INTEGRATED CHANGE CONTROL: OUTPUTS 4.6.3.1 APPROVED CHANGE REQUESTS Change requests (described in Section 4.3.3.4) are processed according to the change management plan by the project manager, CCB, or an assigned team member. As a result, changes may be approved, deferred, or rejected. Approved change requests will be implemented through the Direct and Manage Project Work process. Deferred or rejected change requests are communicated to the person or group requesting the change. The disposition of all change requests are recorded in the change log as a project document update. 4.6.3.2 PROJECT MANAGEMENT PLAN UPDATES Any formally controlled component of the project management plan may be changed as a result of this process. Changes to baselines are only made from the last baseline forward. Past performance is not changed. This protects the integrity of the baselines and the historical data of past performance. 4.6.3.3 PROJECT DOCUMENTS UPDATES Any formally controlled project document may be changed as a result of this process. A project document that is normally updated as a result of this process
  • 165.
    is the changelog. The change log is used to document changes that occur during a project. 4.7 CLOSE PROJECT OR PHASE Close Project or Phase is the process of finalizing all activities for the project, phase, or contract. The key benefits of this process are the project or phase information is archived, the planned work is completed, and organizational team resources are released to pursue new endeavors. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 4-14. Figure 4-15 depicts the data flow diagram for the process.
  • 166.
    When closing theproject, the project manager reviews the project management plan to ensure that all project work is completed and that the project has met its objectives. The activities necessary for the administrative closure of the project or phase include but are not limited to: Actions and activities necessary to satisfy completion or exit criteria for the phase or project such as: Making certain that all documents and deliverables are up-to-date and that all issues are resolved; Confirming the delivery and formal acceptance of deliverables by the customer; Ensuring that all costs are charged to the project; Closing project accounts; Reassigning personnel;
  • 167.
    Dealing with excessproject material; Reallocating project facilities, equipment, and other resources; and Elaborating the final project reports as required by organizational policies. Activities related to the completion of the contractual agreements applicable to the project or project phase such as: Confirming the formal acceptance of the seller's work, Finalizing open claims, Updating records to reflect final results, and Archiving such information for future use. Activities needed to: Collect project or phase records, Audit project success or failure, Manage knowledge sharing and transfer, Identify lessons learned, and Archive project information for future use by the organization. Actions and activities necessary to transfer the project's products, services, or results to the next phase or to production and/or operations. Collecting any suggestions for improving or updating the policies and procedures of the organization, and sending them to the appropriate organizational unit. Measuring stakeholder satisfaction. The Close Project or Phase process also establishes the procedures to investigate and document the reasons for actions taken if a project is terminated before completion. In order to successfully achieve this, the project manager needs to engage all the proper stakeholders in the process. 4.7.1 CLOSE PROJECT OR PHASE: INPUTS 4.7.1.1 PROJECT CHARTER
  • 168.
    Described in Section4.1.3.1. The project charter documents the project success criteria, the approval requirements, and who will sign off on the project. 4.7.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. All components of the project management plan are an input to this process. 4.7.1.3 PROJECT DOCUMENTS Project documents that may be inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log has a record of all the assumptions and constraints that guided the technical specifications, estimates, schedule, risks, etc. Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. The basis of estimates is used to evaluate how the estimation of durations, cost, resources, and cost control compared to the actual results. Change log. Described in Section 4.6.3.3. The change log contains the status of all change requests throughout the project or phase. Issue log. Described in Section 4.3.3.3. The issue log is used to check that there is no open issue. Lessons learned register. Described in Section 4.3.3.1. The lessons learned in the phase or project will be finalized before being entered into the lessons learned repository. Milestone list. Described in Section 6.2.3.3. The milestone list shows the final dates on which the project milestones have been accomplished. Project communications. Described in Section 10.2.3.1. Project communications include any and all communications that have been created throughout the project. Quality control measurements. Described in Section 8.3.3.1. The quality control measurements document the results of Control Quality activities and demonstrate compliance with the quality requirements. Quality reports. Described in Section 8.2.3.1. The information presented in the quality report may include all quality assurance issues managed or escalated by the team, recommendations for improvement,
  • 169.
    and the summaryof findings from the Control Quality process. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation is used to demonstrate compliance with the project scope. Risk register. Described in Section 11.2.3.1. The risk register provides information on risks that have occurred throughout the project. Risk report. Described in Section 11.2.3.2. The risk report provides information on the risk status and is used to check that there are no open risks at the end of the project. 4.7.1.4 ACCEPTED DELIVERABLES Described in Section 5.5.3.1. Accepted deliverables may include approved product specifications, delivery receipts, and work performance documents. Partial or interim deliverables may also be included for phased or cancelled projects. 4.7.1.5 BUSINESS DOCUMENTS Described in Section 1.2.6. Business documents include but are not limited to: Business case. The business case documents the business need and the cost benefit analysis that justify the project. Benefits management plan. The benefits management plan outlines the target benefits of the project. The business case is used to determine if the expected outcomes from the economic feasibility study used to justify the project occurred. The benefits management plan is used to measure whether the benefits of the project were achieved as planned. 4.7.1.6 AGREEMENTS Described in Section 12.2.3.2. The requirements for formal procurement closure are usually defined in the terms and conditions of the contract and are included in the procurement management plan. A complex project may involve managing multiple contracts simultaneously or in sequence. 4.7.1.7 PROCUREMENT DOCUMENTATION
  • 170.
    Described in Section12.3.1.4. To close the contract, all procurement documentation is collected, indexed, and filed. Information on contract schedule, scope, quality, and cost performance along with all contract change documentation, payment records, and inspection results are cataloged. “As-built” plans/drawing or “as-developed” documents, manuals, troubleshooting, and other technical documentation should also be considered as part of the procurement documents when closing a project. This information can be used for lessons learned information and as a basis for evaluating contractors for future contracts. 4.7.1.8 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Close Project or Phase process include but are not limited to: Project or phase closure guidelines or requirements (e.g., lessons learned, final project audits, project evaluations, product validations, acceptance criteria, contract closure, resource reassignment, team performance appraisals, and knowledge transfer). Configuration management knowledge base containing the versions and baselines of all official organizational standards, policies, procedures, and any project documents. 4.7.2 CLOSE PROJECT OR PHASE: TOOLS AND TECHNIQUES 4.7.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Management control, Audit, Legal and procurement, and Legislation and regulations. 4.7.2.2 DATA ANALYSIS Data analysis techniques that can be used in project closeout include but are not limited to:
  • 171.
    Document analysis. Describedin Section 5.2.2.3. Assessing available documentation will allow identifying lessons learned and knowledge sharing for future projects and organizational assets improvement. Regression analysis. This technique analyzes the interrelationships between different project variables that contributed to the project outcomes to improve performance on future projects. Trend analysis. Described in Section 4.5.2.2. Trend analysis can be used to validate the models used in the organization and to implement adjustments for future projects. Variance analysis. Described in Section 4.5.2.2. Variance analysis can be used to improve the metrics of the organization by comparing what was initially planned and the end result. 4.7.2.3 MEETINGS Meetings are used to confirm that the deliverables have been accepted, to validate that the exit criteria have been met, to formalize the completion of the contracts, to evaluate the satisfaction of the stakeholders, to gather lessons learned, to transfer knowledge and information from the project, and to celebrate success. Attendees may include project team members and other stakeholders involved in or affected by the project. Meetings may be face-to-face, virtual, formal, or informal. Types of meetings include but are not limited to close-out reporting meetings, customer wrap-up meetings, lessons learned meetings, and celebration meetings. 4.7.3 CLOSE PROJECT OR PHASE: OUTPUTS 4.7.3.1 PROJECT DOCUMENTS UPDATES All project documents may be updated and marked as final versions as a result of project closure. Of particular interest is the lessons learned register, which is finalized to include final information on phase or project closure. The final lessons learned register may include information on benefits management, accuracy of the business case, project and development life cycles, risk and issue management, stakeholder engagement, and other project management processes. 4.7.3.2 FINAL PRODUCT, SERVICE, OR RESULT TRANSITION
  • 172.
    A product, service,or result, once delivered by the project, may be handed over to a different group or organization that will operate, maintain, and support it throughout its life cycle. This output refers to this transition of the final product, service, or result that the project was authorized to produce (or in the case of phase closure, the intermediate product, service, or result of that phase) from one team to another. 4.7.3.3 FINAL REPORT The final report provides a summary of the project performance. It can include information such as: Summary level description of the project or phase. Scope objectives, the criteria used to evaluate the scope, and evidence that the completion criteria were met. Quality objectives, the criteria used to evaluate the project and product quality, the verification and actual milestone delivery dates, and reasons for variances. Cost objectives, including the acceptable cost range, actual costs, and reasons for any variances. Summary of the validation information for the final product, service, or result. Schedule objectives including whether results achieved the benefits that the project was undertaken to address. If the benefits are not met at the close of the project, indicate the degree to which they were achieved and estimate for future benefits realization. Summary of how the final product, service, or result achieved the business needs identified in the business plan. If the business needs are not met at the close of the project, indicate the degree to which they were achieved and estimate for when the business needs will be met in the future. Summary of any risks or issues encountered on the project and how they were addressed. 4.7.3.4 ORGANIZATIONAL PROCESS ASSET UPDATES Organizational process assets that are updated include but are not limited to:
  • 173.
    Project documents. Documentationresulting from the project's activities; for example, project management plan; scope, cost, schedule, and project calendars; and change management documentation. Operational and support documents. Documents required for an organization to maintain, operate, and support the product or service delivered by the project. These may be new documents or updates to existing documents. Project or phase closure documents. Project or phase closure documents, consisting of formal documentation that indicates completion of the project or phase and the transfer of the completed project or phase deliverables to others, such as an operations group or to the next phase. During project closure, the project manager reviews prior phase documentation, customer acceptance documentation from the Validate Scope process (Section 5.5), and the agreement (if applicable) to ensure that all project requirements are completed prior to finalizing the closure of the project. If the project was terminated prior to completion, the formal documentation indicates why the project was terminated and formalizes the procedures for the transfer of the finished and unfinished deliverables of the cancelled project to others. Lessons learned repository. Lessons learned and knowledge gained throughout the project are transferred to the lessons learned repository for use by future projects.
  • 174.
    5 PROJECT SCOPE MANAGEMENT ProjectScope Management includes the processes required to ensure that the project includes all the work required, and only the work required, to complete the project successfully. Managing the project scope is primarily concerned with defining and controlling what is and is not included in the project. The Project Scope Management processes are: 5.1 Plan Scope Management—The process of creating a scope management plan that documents how the project and product scope will be defined, validated, and controlled. 5.2 Collect Requirements—The process of determining, documenting, and managing stakeholder needs and requirements to meet project objectives. 5.3 Define Scope—The process of developing a detailed description of the project and product. 5.4 Create WBS—The process of subdividing project deliverables and project work into smaller, more manageable components. 5.5 Validate Scope—The process of formalizing acceptance of the completed project deliverables. 5.6 Control Scope—The process of monitoring the status of the project and product scope and managing changes to the scope baseline. Figure 5-1 provides an overview of the Project Scope Management processes. The Project Scope Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 175.
    KEY CONCEPTS FORPROJECT SCOPE MANAGEMENT In the project context, the term “scope” can refer to: Product scope. The features and functions that characterize a product, service, or result. Project scope. The work performed to deliver a product, service, or result with the specified features and functions. The term “project scope” is sometimes viewed as including product scope. Project life cycles can range along a continuum from predictive approaches at one end to adaptive or agile approaches at the other. In a predictive life cycle, the project deliverables are defined at the beginning of the project and any changes to the scope are progressively managed. In an adaptive or agile life cycle, the deliverables are developed over multiple iterations where a detailed
  • 176.
    scope is definedand approved for each iteration when it begins. Projects with adaptive life cycles are intended to respond to high levels of change and require ongoing stakeholder engagement. The overall scope of an adaptive project will be decomposed into a set of requirements and work to be performed, sometimes referred to as a product backlog. At the beginning of an iteration, the team will work to determine how many of the highest-priority items on the backlog list can be delivered within the next iteration. Three processes (Collect Requirements, Define Scope, and Create WBS) are repeated for each iteration. On the contrary, in a predictive project, these processes are performed toward the beginning of the project and updated as necessary, using the integrated change control process. In an adaptive or agile life cycle, the sponsor and customer representatives should be continuously engaged with the project to provide feedback on deliverables as they are created and to ensure that the product backlog reflects their current needs. Two processes (Validate Scope and Control Scope) are repeated for each iteration. On the contrary, in a predictive project, Validate Scope occurs with each deliverable or phase review and Control Scope is an ongoing process. In predictive projects, the scope baseline for the project is the approved version of the project scope statement, work breakdown structure (WBS), and its associated WBS dictionary. A baseline can be changed only through formal change control procedures and is used as a basis for comparison while performing Validate Scope and Control Scope processes as well as other controlling processes. Projects with adaptive life cycles use backlogs (including product requirements and user stories) to reflect their current needs. Completion of the project scope is measured against the project management plan, while completion of the product scope is measured against the product requirements. The term “requirement” is defined as a condition or capability that is required to be present in a product, service, or result to satisfy an agreement or other formally imposed specification. Validate Scope is the process of formalizing acceptance of the completed project deliverables. The verified deliverables obtained from the Control Quality process are an input to the Validate Scope process. One of the outputs of Validate Scope is accepted deliverables that are formally signed off and approved by the authorized stakeholder. Therefore, the stakeholder needs to get involved early on during planning (sometimes initiating as well) and to provide inputs about quality of deliverables so that Control Quality can assess the
  • 177.
    performance and recommendnecessary changes. TRENDS AND EMERGING PRACTICES IN PROJECT SCOPE MANAGEMENT Requirements have always been a concern in project management and have continued to gain more attention in the profession. As the global environment becomes more complex, organizations are starting to recognize how to use business analysis to their competitive advantage by defining, managing, and controlling requirements activities. Activities of business analysis may start before a project is initiated and a project manager is assigned. According to Requirements Management: A Practice Guide [14], the requirements management process starts with a needs assessment, which may begin in portfolio planning, in program planning, or within a discrete project. Eliciting, documenting, and managing stakeholder requirements takes place within the Project Scope Management processes. Trends and emerging practices for Project Scope Management include but are not limited to a focus on collaborating with business analysis professionals to: Determine problems and identify business needs; Identify and recommend viable solutions for meeting those needs; Elicit, document, and manage stakeholder requirements in order to meet business and project objectives; and Facilitate the successful implementation of the product, service, or end result of the program or project [7]. The process ends with the requirements closure, which transitions the product, service, or result to the recipient in order to measure, monitor, realize, and sustain benefits over time. The role with responsibility to conduct business analysis should be assigned to resources with sufficient business analysis skills and expertise. If a business analyst is assigned to a project, requirement-related activities are the responsibility of that role. The project manager is responsible for ensuring that requirements-related work is accounted for in the project management plan and that requirements-related activities are performed on time and within budget and deliver value. The relationship between a project manager and a business analyst should be a collaborative partnership. A project will have a higher likelihood of being
  • 178.
    successful if projectmanagers and business analysts fully understand each other's roles and responsibilities to successfully achieve project objectives. TAILORING CONSIDERATIONS Because each project is unique, the project manager will need to tailor the way Project Scope Management processes are applied. Considerations for tailoring include but are not limited to: Knowledge and requirements management. Does the organization have formal or informal knowledge and requirements management systems? What guidelines should the project manager establish for requirements to be reused in the future? Validation and control. Does the organization have existing formal or informal validation and control-related policies, procedures, and guidelines? Development approach. Does the organization use agile approaches in managing projects? Is the development approach iterative or incremental? Is a predictive approach used? Will a hybrid approach be productive? Stability of requirements. Are there areas of the project with unstable requirements? Do unstable requirements necessitate the use of lean, agile, or other adaptive techniques until they are stable and well defined? Governance. Does the organization have formal or informal audit and governance policies, procedures, and guidelines? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS In projects with evolving requirements, high risk, or significant uncertainty, the scope is often not understood at the beginning of the project or it evolves during the project. Agile methods deliberately spend less time trying to define and agree on scope in the early stage of the project and spend more time establishing the process for its ongoing discovery and refinement. Many environments with emerging requirements find that there is often a gap between the real business requirements and the business requirements that were originally stated. Therefore, agile methods purposefully build and review prototypes and release versions in order to refine the requirements. As a result, scope is defined and redefined throughout the project. In agile approaches, the requirements
  • 179.
    constitute the backlog. 5.1PLAN SCOPE MANAGEMENT Plan Scope Management is the process of creating a scope management plan that documents how the project and product scope will be defined, validated, and controlled. The key benefit of this process is that it provides guidance and direction on how scope will be managed throughout the project. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-2. Figure 5-3 depicts the data flow diagram of the process.
  • 180.
    The scope managementplan is a component of the project or program management plan that describes how the scope will be defined, developed, monitored, controlled, and validated. The development of the scope management plan and the detailing of the project scope begin with the analysis of information contained in the project charter (Section 4.1.3.1), the latest approved subsidiary plans of the project management plan (Section 4.2.3.1), historical information contained in the organizational process assets (Section 2.3), and any other relevant enterprise environmental factors (Section 2.2). 5.1.1 PLAN SCOPE MANAGEMENT: INPUTS 5.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter documents the project purpose, high-level project description, assumptions, constraints, and high-level requirements that the project is intended to satisfy. 5.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to:
  • 181.
    Quality management plan.Described in Section 8.1.3.1. The way the project and product scope will be managed can be influenced by how the organization's quality policy, methodologies, and standards are implemented on the project. Project life cycle description. The project life cycle determines the series of phases that a project passes through from its inception to the end of the project. Development approach. The development approach defines whether waterfall, iterative, adaptive, agile, or a hybrid development approach will be used. 5.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Scope Management process include but are not limited to: Organization's culture, Infrastructure, Personnel administration, and Marketplace conditions. 5.1.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Scope Management process include but are not limited to: Policies and procedures, and Historical information and lessons learned repositories. 5.1.2 PLAN SCOPE MANAGEMENT: TOOLS AND TECHNIQUES 5.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Previous similar projects, and
  • 182.
    Information in theindustry, discipline, and application area. 5.1.2.2 DATA ANALYSIS A data analysis technique that can be used for this process includes but is not limited to alternatives analysis. Various ways of collecting requirements, elaborating the project and product scope, creating the product, validating the scope, and controlling the scope are evaluated. 5.1.2.3 MEETINGS Project teams may attend project meetings to develop the scope management plan. Attendees may include the project manager, the project sponsor, selected project team members, selected stakeholders, anyone with responsibility for any of the scope management processes, and others as needed. 5.1.3 PLAN SCOPE MANAGEMENT: OUTPUTS 5.1.3.1 SCOPE MANAGEMENT PLAN The scope management plan is a component of the project management plan that describes how the scope will be defined, developed, monitored, controlled, and validated. The components of a scope management plan include: Process for preparing a project scope statement; Process that enables the creation of the WBS from the detailed project scope statement; Process that establishes how the scope baseline will be approved and maintained; and Process that specifies how formal acceptance of the completed project deliverables will be obtained. The scope management plan can be formal or informal, broadly framed or highly detailed, based on the needs of the project. 5.1.3.2 REQUIREMENTS MANAGEMENT PLAN The requirements management plan is a component of the project management plan that describes how project and product requirements will be analyzed, documented, and managed. According to Business Analysis for
  • 183.
    Practitioners: A PracticeGuide [7], some organizations refer to it as a business analysis plan. Components of the requirements management plan can include but are not limited to: How requirements activities will be planned, tracked, and reported; Configuration management activities such as: how changes will be initiated; how impacts will be analyzed; how they will be traced, tracked, and reported; as well as the authorization levels required to approve these changes; Requirements prioritization process; Metrics that will be used and the rationale for using them; and Traceability structure that reflects the requirement attributes captured on the traceability matrix. 5.2 COLLECT REQUIREMENTS Collect Requirements is the process of determining, documenting, and managing stakeholder needs and requirements to meet objectives. The key benefit of this process is that it provides the basis for defining the product scope and project scope. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-4. Figure 5-5 depicts the data flow diagram of the process.
  • 185.
    The PMBOK® Guidedoes not specifically address product requirements since those are industry specific. Note that Business Analysis for Practitioners: A Practice Guide [7] provides more in-depth information about product requirements. The project's success is directly influenced by active stakeholder involvement in the discovery and decomposition of needs into project and product requirements and by the care taken in determining, documenting, and managing the requirements of the product, service, or result of the project. Requirements include conditions or capabilities that are required to be present in a product, service, or result to satisfy an agreement or other formally imposed specification. Requirements include the quantified and documented needs and expectations of the sponsor, customer, and other stakeholders. These requirements need to be elicited, analyzed, and recorded in enough detail to be
  • 186.
    included in thescope baseline and to be measured once project execution begins. Requirements become the foundation of the WBS. Cost, schedule, quality planning, and procurement are all based on these requirements. 5.2.1 COLLECT REQUIREMENTS: INPUTS 5.2.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter documents the high-level project description and high-level requirements that will be used to develop detailed requirements. 5.2.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The scope management plan contains information on how the project scope will be defined and developed. Requirements management plan. Described in Section 5.1.3.2. The requirements management plan has information on how project requirements will be collected, analyzed, and documented. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan is used to understand stakeholder communication requirements and the level of stakeholder engagement in order to assess and adapt to the level of stakeholder participation in requirements activities. 5.2.1.3 PROJECT DOCUMENTS Examples of project documents that can be considered as inputs for this process include but are not limited to: Assumption Log. Described in Section 4.1.3.2. The assumption log identified assumptions about the product, project, environment, stakeholders, and other factors that can influence requirements. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is used to provide information on effective
  • 187.
    requirements collection techniques,especially for projects that are using an iterative or adaptive product development methodology. Stakeholder Register. Described in Section 13.1.3.1. The stakeholder register is used to identify stakeholders who can provide information on the requirements. It also captures requirements and expectations that stakeholders have for the project. 5.2.1.4 BUSINESS DOCUMENTS Described in Section 1.2.6. A business document that can influence the Collect Requirements process is the business case, which can describe required, desired, and optional criteria for meeting the business needs. 5.2.1.5 AGREEMENTS Described in Section 12.2.3.2. Agreements can contain project and product requirements. 5.2.1.6 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Collect Requirements process include but are not limited to: Organization's culture, Infrastructure, Personnel administration, and Marketplace conditions. 5.2.1.7 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Collect Requirements process include but are not limited to: Policies and procedures, and Historical information and lessons learned repository with information from previous projects. 5.2.2 COLLECT REQUIREMENTS: TOOLS AND TECHNIQUES
  • 188.
    5.2.2.1 EXPERT JUDGMENT Describedin Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Business analysis, Requirements elicitation, Requirements analysis, Requirements documentation, Project requirements in previous similar projects, Diagramming techniques, Facilitation, and Conflict management. 5.2.2.2 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to: Brainstorming. Described in Section 4.1.2.2. Brainstorming is a technique used to generate and collect multiple ideas related to project and product requirements. Interviews. An interview is a formal or informal approach to elicit information from stakeholders by talking to them directly. It is typically performed by asking prepared and spontaneous questions and recording the responses. Interviews are often conducted on an individual basis between an interviewer and an interviewee, but may involve multiple interviewers and/or multiple interviewees. Interviewing experienced project participants, sponsors, other executives, and subject matter experts can aid in identifying and defining the features and functions of the desired product deliverables. Interviews are also useful for obtaining confidential information. Focus groups. Focus groups bring together prequalified stakeholders and subject matter experts to learn about their expectations and attitudes about a proposed product, service, or result. A trained moderator guides the group through an interactive discussion designed to be more conversational than a one-on-one interview.
  • 189.
    Questionnaires and surveys.Questionnaires and surveys are written sets of questions designed to quickly accumulate information from a large number of respondents. Questionnaires and/or surveys are most appropriate with varied audiences, when a quick turnaround is needed, when respondents are geographically dispersed, and where statistical analysis could be appropriate. Benchmarking. Described in Section 8.1.2.2. Benchmarking involves comparing actual or planned products, processes, and practices to those of comparable organizations to identify best practices, generate ideas for improvement, and provide a basis for measuring performance. The organizations compared during benchmarking can be internal or external. 5.2.2.3 DATA ANALYSIS Described in Section 4.5.2.2. Data analysis techniques that can be used for this process include but are not limited to document analysis. Document analysis consists of reviewing and assessing any relevant documented information. In this process, document analysis is used to elicit requirements by analyzing existing documentation and identifying information relevant to the requirements. There is a wide range of documents that may be analyzed to help elicit relevant requirements. Examples of documents that may be analyzed include but are not limited to: Agreements; Business plans; Business process or interface documentation; Business rules repositories; Current process flows; Marketing literature; Problem/issue logs; Policies and procedures; Regulatory documentation such as laws, codes, or ordinances, etc.; Requests for proposal; and Use cases.
  • 190.
    5.2.2.4 DECISION MAKING Decision-makingtechniques that can be used in the Collect Requirements process include but are not limited to: Voting. Voting is a collective decision-making technique and an assessment process having multiple alternatives with an expected outcome in the form of future actions. These techniques can be used to generate, classify, and prioritize product requirements. Examples of voting techniques include: Unanimity. A decision that is reached whereby everyone agrees on a single course of action. Majority. A decision that is reached with support obtained from more than 50% of the members of the group. Having a group size with an uneven number of participants can ensure that a decision will be reached, rather than resulting in a tie. Plurality. A decision that is reached whereby the largest block in a group decides, even if a majority is not achieved. This method is generally used when the number of options nominated is more than two. Autocratic decision making. In this method, one individual takes responsibility for making the decision for the group. Multicriteria decision analysis. A technique that uses a decision matrix to provide a systematic analytical approach for establishing criteria, such as risk levels, uncertainty, and valuation, to evaluate and rank many ideas. 5.2.2.5 DATA REPRESENTATION Data representation techniques that can be used for this process include but are not limited to: Affinity diagrams. Affinity diagrams allow large numbers of ideas to be classified into groups for review and analysis. Mind mapping. Mind mapping consolidates ideas created through individual brainstorming sessions into a single map to reflect commonality and differences in understanding and to generate new ideas.
  • 191.
    5.2.2.6 INTERPERSONAL ANDTEAM SKILLS Described in Section 4.1.2.3. The interpersonal and team skills that can be used in this process include but are not limited to: Nominal group technique. The nominal group technique enhances brainstorming with a voting process used to rank the most useful ideas for further brainstorming or for prioritization. The nominal group technique is a structured form of brainstorming consisting of four steps: A question or problem is posed to the group. Each person silently generates and writes down their ideas. The moderator writes down the ideas on a flip chart until all ideas are recorded. Each recorded idea is discussed until all group members have a clear understanding. Individuals vote privately to prioritize the ideas, usually using a scale of 1 – 5, with 1 being the lowest and 5 being the highest. Voting may take place in many rounds to reduce and focus in on ideas. After each round, the votes are tallied and the highest scoring ideas are selected. Observation/conversation. Observation and conversation provide a direct way of viewing individuals in their environment and how they perform their jobs or tasks and carry out processes. It is particularly helpful for detailed processes when the people who use the product have difficulty or are reluctant to articulate their requirements. Observation is also known as “job shadowing.” It is usually done externally by an observer viewing a business expert performing a job. It can also be done by a “participant observer” who actually performs a process or procedure to experience how it is done to uncover hidden requirements. Facilitation. Described in Section 4.1.2.3. Facilitation is used with focused sessions that bring key stakeholders together to define product requirements. Workshops can be used to quickly define cross- functional requirements and reconcile stakeholder differences. Because of their interactive group nature, well-facilitated sessions can build trust, foster relationships, and improve communication among the participants, which can lead to increased stakeholder consensus. In
  • 192.
    addition, issues canbe discovered earlier and resolved more quickly than in individual sessions. Facilitation skills are used in the following situations, but are not limited to: Joint application design/development (JAD). JAD sessions are used in the software development industry. These facilitated sessions focus on bringing business subject matter experts and the development team together to gather requirements and improve the software development process. Quality function deployment (QFD). In the manufacturing industry, QFD is another facilitation technique that helps determine critical characteristics for new product development. QFD starts by collecting customer needs, also known as voice of the customer (VOC). These needs are then objectively sorted and prioritized, and goals are set for achieving them. User stories. User stories, which are short, textual descriptions of required functionality, are often developed during a requirements workshop. User stories describe the stakeholder role, who benefits from the feature (role), what the stakeholder needs to accomplish (goal), and the benefit to the stakeholder (motivation). 5.2.2.7 CONTEXT DIAGRAM The context diagram is an example of a scope model. Context diagrams visually depict the product scope by showing a business system (process, equipment, computer system, etc.), and how people and other systems (actors) interact with it (see Figure 5-6). Context diagrams show inputs to the business system, the actor(s) providing the input, the outputs from the business system, and the actor(s) receiving the output.
  • 193.
    5.2.2.8 PROTOTYPES Prototyping isa method of obtaining early feedback on requirements by providing a model of the expected product before actually building it. Examples of prototypes are small-scale products, computer generated 2D and 3D models, mock-ups, or simulations. Prototypes allow stakeholders to experiment with a model of the final product rather than being limited to discussing abstract representations of their requirements. Prototypes support the concept of progressive elaboration in iterative cycles of mock-up creation, user experimentation, feedback generation, and prototype revision. When enough feedback cycles have been performed, the requirements obtained from the prototype are sufficiently complete to move to a design or build phase. Storyboarding is a prototyping technique showing sequence or navigation through a series of images or illustrations. Storyboards are used on a variety of projects in a variety of industries, such as film, advertising, instructional design, and on agile and other software development projects. In software development,
  • 194.
    storyboards use mock-upsto show navigation paths through web pages, screens, or other user interfaces. 5.2.3 COLLECT REQUIREMENTS: OUTPUTS 5.2.3.1 REQUIREMENTS DOCUMENTATION Requirements documentation describes how individual requirements meet the business need for the project. Requirements may start out at a high level and become progressively more detailed as more information about the requirements is known. Before being baselined, requirements need to be unambiguous (measurable and testable), traceable, complete, consistent, and acceptable to key stakeholders. The format of the requirements document may range from a simple document listing all the requirements categorized by stakeholder and priority, to more elaborate forms containing an executive summary, detailed descriptions, and attachments. Many organizations categorize requirements into different types, such as business and technical solutions, the former referring to stakeholder needs and the latter as to how those needs will be implemented. Requirements can be grouped into classifications allowing for further refinement and detail as the requirements are elaborated. These classifications include: Business requirements. These describe the higher-level needs of the organization as a whole, such as the business issues or opportunities, and reasons why a project has been undertaken. Stakeholder requirements. These describe needs of a stakeholder or stakeholder group. Solution requirements. These describe features, functions, and characteristics of the product, service, or result that will meet the business and stakeholder requirements. Solution requirements are further grouped into functional and nonfunctional requirements: Functional requirements. Functional requirements describe the behaviors of the product. Examples include actions, processes, data, and interactions that the product should execute. Nonfunctional requirements. Nonfunctional requirements supplement functional requirements and describe the environmental conditions or qualities required for the product to be effective.
  • 195.
    Examples include: reliability,security, performance, safety, level of service, supportability, retention/purge, etc. Transition and readiness requirements. These describe temporary capabilities, such as data conversion and training requirements, needed to transition from the current as-is state to the desired future state. Project requirements. These describe the actions, processes, or other conditions the project needs to meet. Examples include milestone dates, contractual obligations, constraints, etc. Quality requirements. These capture any condition or criteria needed to validate the successful completion of a project deliverable or fulfillment of other project requirements. Examples include tests, certifications, validations, etc. 5.2.3.2 REQUIREMENTS TRACEABILITY MATRIX The requirements traceability matrix is a grid that links product requirements from their origin to the deliverables that satisfy them. The implementation of a requirements traceability matrix helps ensure that each requirement adds business value by linking it to the business and project objectives. It provides a means to track requirements throughout the project life cycle, helping to ensure that requirements approved in the requirements documentation are delivered at the end of the project. Finally, it provides a structure for managing changes to the product scope. Tracing requirements includes but is not limited to: Business needs, opportunities, goals, and objectives; Project objectives; Project scope and WBS deliverables; Product design; Product development; Test strategy and test scenarios; and High-level requirements to more detailed requirements. Attributes associated with each requirement can be recorded in the requirements traceability matrix. These attributes help to define key information about the requirement. Typical attributes used in the requirements traceability matrix may include: a unique identifier, a textual description of the requirement,
  • 196.
    the rationale forinclusion, owner, source, priority, version, current status (such as active, cancelled, deferred, added, approved, assigned, completed), and status date. Additional attributes to ensure that the requirement has met stakeholders’ satisfaction may include stability, complexity, and acceptance criteria. Figure 5- 7 provides an example of a requirements traceability matrix with its associated attributes. 5.3 DEFINE SCOPE Define Scope is the process of developing a detailed description of the project and product. The key benefit of this process is that it describes the product, service, or result boundaries and acceptance criteria. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-8. Figure 5-9 depicts the data flow diagram of the process.
  • 197.
    Since all therequirements identified in Collect Requirements may not be included in the project, the Define Scope process selects the final project requirements from the requirements documentation developed during the Collect Requirements process. It then develops a detailed description of the project and product, service, or result. The preparation of a detailed project scope statement builds upon the major
  • 198.
    deliverables, assumptions, andconstraints that are documented during project initiation. During project planning, the project scope is defined and described with greater specificity as more information about the project is known. Existing risks, assumptions, and constraints are analyzed for completeness and added or updated as necessary. The Define Scope process can be highly iterative. In iterative life cycle projects, a high-level vision will be developed for the overall project, but the detailed scope is determined one iteration at a time, and the detailed planning for the next iteration is carried out as work progresses on the current project scope and deliverables. 5.3.1 DEFINE SCOPE: INPUTS 5.3.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter provides the high-level project description, product characteristics, and approval requirements. 5.3.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. A project management plan component includes but is not limited to the scope management plan as described in Section 5.1.3.1, which documents how the project scope will be defined, validated, and controlled. 5.3.1.3 PROJECT DOCUMENTS Examples of project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log identifies assumptions and constraints about the product, project, environment, stakeholders, and other factors that can influence the project and product scope. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation identifies requirements that will be incorporated into the scope. Risk register. Described in Section 11.2.3.1. The risk register contains response strategies that may affect the project scope, such as reducing or changing project and product scope to avoid or mitigate a risk.
  • 199.
    5.3.1.4 ENTERPRISE ENVIRONMENTALFACTORS The enterprise environmental factors that can influence the Define Scope process include but are not limited to: Organization's culture, Infrastructure, Personnel administration, and Marketplace conditions. 5.3.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Define Scope process include but are not limited to: Policies, procedures, and templates for a project scope statement; Project files from previous projects; and Lessons learned from previous phases or projects. 5.3.2 DEFINE SCOPE: TOOLS AND TECHNIQUES 5.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with knowledge of or experience with similar projects. 5.3.2.2 DATA ANALYSIS An example of a data analysis technique that can be used in this process includes but is not limited to alternatives analysis. Alternatives analysis can be used to evaluate ways to meet the requirements and the objectives identified in the charter. 5.3.2.3 DECISION MAKING Described in Section 5.1.2.2. A decision-making technique that can be used in this process includes but is not limited to multicriteria decision analysis. Described in Section 8.1.2.4, multicriteria decision analysis is a technique that uses a decision matrix to provide a systematic analytical approach for
  • 200.
    establishing criteria, suchas requirements, schedule, budget, and resources, in order to refine the project and product scope for the project. 5.3.2.4 INTERPERSONAL AND TEAM SKILLS Described in Section 4.1.2.3. An example of an interpersonal and team skills technique is facilitation. Facilitation is used in workshops and working sessions with key stakeholders who have a variety of expectations or fields of expertise. The goal is to reach a cross-functional and common understanding of the project deliverables and project and product boundaries. 5.3.2.5 PRODUCT ANALYSIS Product analysis can be used to define products and services. It includes asking questions about a product or service and forming answers to describe the use, characteristics, and other relevant aspects of what is going to be delivered. Each application area has one or more generally accepted methods for translating high-level product or service descriptions into meaningful deliverables. Requirements are captured at a high level and decomposed to the level of detail needed to design the final product. Examples of product analysis techniques include but are not limited to: Product breakdown, Requirements analysis, Systems analysis, Systems engineering, Value analysis, and Value engineering. 5.3.3 DEFINE SCOPE: OUTPUTS 5.3.3.1 PROJECT SCOPE STATEMENT The project scope statement is the description of the project scope, major deliverables, assumptions, and constraints. The project scope statement documents the entire scope, including project and product scope. It describes the project's deliverables in detail. It also provides a common understanding of the project scope among project stakeholders. It may contain explicit scope
  • 201.
    exclusions that canassist in managing stakeholder expectations. It enables the project team to perform more detailed planning, guides the project team's work during execution, and provides the baseline for evaluating whether requests for changes or additional work are contained within or outside the project's boundaries. The degree and level of detail to which the project scope statement defines the work that will be performed and the work that is excluded can help determine how well the project management team can control the overall project scope. The detailed project scope statement, either directly or by reference to other documents, includes the following: Product scope description. Progressively elaborates the characteristics of the product, service, or result described in the project charter and requirements documentation. Deliverables. Any unique and verifiable product, result, or capability to perform a service that is required to be produced to complete a process, phase, or project. Deliverables also include ancillary results, such as project management reports and documentation. These deliverables may be described at a summary level or in great detail. Acceptance criteria. A set of conditions that is required to be met before deliverables are accepted. Project exclusions. Identifies what is excluded from the project. Explicitly stating what is out of scope for the project helps manage stakeholders’ expectations and can reduce scope creep. Although the project charter and the project scope statement are sometimes perceived as containing a certain degree of redundancy, they are different in the level of detail contained in each. The project charter contains high-level information, while the project scope statement contains a detailed description of the scope components. These components are progressively elaborated throughout the project. Table 5-1 describes some of the key elements for each document.
  • 202.
    5.3.3.2 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log is updated with additional assumptions or constraints that were identified during this process. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may be updated with additional or changed requirements. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix may be updated to reflect updates in requirement documentation. Stakeholder register. Described in Section 13.1.3.1. Where additional information on existing or new stakeholders is gathered as a result of this process, it is recorded in the stakeholder register.
  • 203.
    5.4 CREATE WBS CreateWBS is the process of subdividing project deliverables and project work into smaller, more manageable components. The key benefit of this process is that it provides a framework of what has to be delivered. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-10. Figure 5-11 depicts the data flow diagram of the process. The WBS is a hierarchical decomposition of the total scope of work to be
  • 204.
    carried out bythe project team to accomplish the project objectives and create the required deliverables. The WBS organizes and defines the total scope of the project and represents the work specified in the current approved project scope statement. The planned work is contained within the lowest level of WBS components, which are called work packages. A work package can be used to group the activities where work is scheduled and estimated, monitored, and controlled. In the context of the WBS, work refers to work products or deliverables that are the result of activity and not to the activity itself. 5.4.1 CREATE WBS: INPUTS 5.4.1.1 PROJECT MANAGEMENT PLAN A project management plan component includes but is not limited to the scope management plan. Described in Section 5.1.3.1, the scope management plan documents how the WBS will be created from the project scope statement. 5.4.1.2 PROJECT DOCUMENTS Examples of project documents that can be considered as inputs for this process include but are not limited to: Project scope statement. Described in Section 5.3.3.1. The project scope statement describes the work that will be performed and the work that is excluded. Requirements documentation. Described in Section 5.2.3.1. Detailed requirements describe how individual requirements meet the business need for the project. 5.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Create WBS process include but are not limited to industry-specific WBS standards that are relevant to the nature of the project. These industry-specific standards may serve as external reference sources for creating the WBS. 5.4.1.4 ORGANIZATIONAL PROCESS ASSETS
  • 205.
    The organizational processassets that can influence the Create WBS process include but are not limited to: Policies, procedures, and templates for the WBS; Project files from previous projects; and Lessons learned from previous projects. 5.4.2 CREATE WBS: TOOLS AND TECHNIQUES 5.4.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with knowledge of or experience with similar projects. 5.4.2.2 DECOMPOSITION Decomposition is a technique used for dividing and subdividing the project scope and project deliverables into smaller, more manageable parts. The work package is the work defined at the lowest level of the WBS for which cost and duration can be estimated and managed. The level of decomposition is often guided by the degree of control needed to effectively manage the project. The level of detail for work packages will vary with the size and complexity of the project. Decomposition of the total project work into work packages generally involves the following activities: Identifying and analyzing the deliverables and related work, Structuring and organizing the WBS, Decomposing the upper WBS levels into lower-level detailed components, Developing and assigning identification codes to the WBS components, and Verifying that the degree of decomposition of the deliverables is appropriate. A portion of a WBS with some branches of the WBS decomposed down through the work package level is shown in Figure 5-12.
  • 206.
    A WBS structuremay be created through various approaches. Some of the popular methods include the top-down approach, the use of organization-specific guidelines, and the use of WBS templates. A bottom-up approach can be used to group subcomponents. The WBS structure can be represented in a number of forms, such as: Using phases of the project life cycle as the second level of decomposition, with the product and project deliverables inserted at the third level, as shown in Figure 5-13; Using major deliverables as the second level of decomposition, as shown in Figure 5-14; and Incorporating subcomponents that may be developed by organizations outside the project team, such as contracted work. The seller then develops the supporting contract WBS as part of the contracted work.
  • 207.
    Decomposition of theupper-level WBS components requires subdividing the work for each of the deliverables or subcomponents into its most fundamental components, where the WBS components represent verifiable products, services, or results. If an agile approach is used, epics can be decomposed into user
  • 208.
    stories. The WBSmay be structured as an outline, an organizational chart, or other method that identifies a hierarchical breakdown. Verifying the correctness of the decomposition requires determining that the lower-level WBS components are those that are necessary and sufficient for completion of the corresponding higher-level deliverables. Different deliverables can have different levels of decomposition. To arrive at a work package, the work for some deliverables needs to be decomposed only to the next level, while others need additional levels of decomposition. As the work is decomposed to greater levels of detail, the ability to plan, manage, and control the work is enhanced. However, excessive decomposition can lead to nonproductive management effort, inefficient use of resources, decreased efficiency in performing the work, and difficulty aggregating data over different levels of the WBS. Decomposition may not be possible for a deliverable or subcomponent that will be accomplished far into the future. The project management team usually waits until the deliverable or subcomponent is agreed on, so the details of the WBS can be developed. This technique is sometimes referred to as rolling wave planning. The WBS represents all product and project work, including the project management work. The total of the work at the lowest levels should roll up to the higher levels so that nothing is left out and no extra work is performed. This is sometimes called the 100 percent rule. For specific information regarding the WBS, refer to the Practice Standard for Work Breakdown Structures – Second Edition [15]. This standard contains industry-specific examples of WBS templates that can be tailored to specific projects in a particular application area. 5.4.3 CREATE WBS: OUTPUTS 5.4.3.1 SCOPE BASELINE The scope baseline is the approved version of a scope statement, WBS, and its associated WBS dictionary, which can be changed only through formal change control procedures and is used as a basis for comparison. It is a component of the project management plan. Components of the scope baseline include: Project scope statement. The project scope statement includes the description of the project scope, major deliverables, assumptions, and constraints (Section 5.3.3.1).
  • 209.
    WBS. The WBSis a hierarchical decomposition of the total scope of work to be carried out by the project team to accomplish the project objectives and create the required deliverables. Each descending level of the WBS represents an increasingly detailed definition of the project work. Work package. The lowest level of the WBS is a work package with a unique identifier. These identifiers provide a structure for hierarchical summation of costs, schedule, and resource information and form a code of accounts. Each work package is part of a control account. A control account is a management control point where scope, budget, and schedule are integrated and compared to the earned value for performance measurement. A control account has two or more work packages, though each work package is associated with a single control account. Planning package. A control account may include one or more planning packages. A planning package is a work breakdown structure component below the control account and above the work package with known work content but without detailed schedule activities. WBS dictionary. The WBS dictionary is a document that provides detailed deliverable, activity, and scheduling information about each component in the WBS. The WBS dictionary is a document that supports the WBS. Most of the information included in the WBS dictionary is created by other processes and added to this document at a later stage. Information in the WBS dictionary may include but is not limited to: Code of account identifier, Description of work, Assumptions and constraints, Responsible organization, Schedule milestones, Associated schedule activities, Resources required, Cost estimates, Quality requirements,
  • 210.
    Acceptance criteria, Technical references,and Agreement information. 5.4.3.2 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log is updated with additional assumptions or constraints that were identified during the Create WBS process. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may be updated to include approved changes resulting from the Create WBS process. 5.5 VALIDATE SCOPE Validate Scope is the process of formalizing acceptance of the completed project deliverables. The key benefit of this process is that it brings objectivity to the acceptance process and increases the probability of final product, service, or result acceptance by validating each deliverable. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-15. Figure 5-16 depicts the data flow diagram of the process.
  • 212.
    The verified deliverablesobtained from the Control Quality process are reviewed with the customer or sponsor to ensure they are completed satisfactorily and have received formal acceptance of the deliverables by the customer or sponsor. In this process, the outputs obtained as a result of the Planning processes in the Project Scope Management Knowledge Area, such as the requirements documentation or the scope baseline, as well as the work performance data obtained from the Execution processes in other Knowledge Areas, are the basis for performing the validation and for final acceptance. The Validate Scope process differs from the Control Quality process in that the former is primarily concerned with acceptance of the deliverables, while the latter is primarily concerned with correctness of the deliverables and meeting the quality requirements specified for the deliverables. Control Quality is generally performed before Validate Scope, although the two processes may be performed in parallel. 5.5.1 VALIDATE SCOPE: INPUTS 5.5.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The project management plan specifies how formal acceptance of the completed project deliverables will be obtained. Requirements management plan. Described in Section 5.1.3.2. The requirements management plan describes how the project requirements are validated. Scope baseline. Described in Section 5.4.3.1. The scope baseline is compared to actual results to determine if a change, corrective action, or preventive action is necessary. 5.5.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register: Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to
  • 213.
    improve the efficiencyand effectiveness of validating deliverables. Quality reports. Described in Section 8.2.3.1. The information presented in the quality report may include all quality assurance issues managed or escalated by the team, recommendations for improvement, and the summary of findings from the Control Quality process. This information is reviewed prior to product acceptance. Requirements documentation. Described in Section 5.2.3.1. Requirements are compared to the actual results to determine if a change, corrective action, or preventive action is necessary. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix contains information about requirements, including how they will be validated. 5.5.1.3 VERIFIED DELIVERABLES Verified deliverables are project deliverables that are completed and checked for correctness through the Control Quality process. 5.5.1.4 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data can include the degree of compliance with requirements, number of nonconformities, severity of the nonconformities, or the number of validation cycles performed in a period of time. 5.5.2 VALIDATE SCOPE: TOOLS AND TECHNIQUES 5.5.2.1 INSPECTION Described in Section 8.3.2.3. Inspection includes activities such as measuring, examining, and validating to determine whether work and deliverables meet requirements and product acceptance criteria. Inspections are sometimes called reviews, product reviews, and walkthroughs. In some application areas, these different terms have unique and specific meanings. 5.5.2.2 DECISION MAKING Described in Section 5.2.2.4. An example of decision making that may be used in this process includes but is not limited to voting. Voting is used to reach
  • 214.
    a conclusion whenthe validation is performed by the project team and other stakeholders. 5.5.3 VALIDATE SCOPE: OUTPUTS 5.5.3.1 ACCEPTED DELIVERABLES Deliverables that meet the acceptance criteria are formally signed off and approved by the customer or sponsor. Formal documentation received from the customer or sponsor acknowledging formal stakeholder acceptance of the project's deliverables is forwarded to the Close Project or Phase process (Section 4.7). 5.5.3.2 WORK PERFORMANCE INFORMATION Work performance information includes information about project progress, such as which deliverables have been accepted and which have not been accepted and the reasons why. This information is documented as described in Section 10.3.3.1 and communicated to stakeholders. 5.5.3.3 CHANGE REQUESTS The completed deliverables that have not been formally accepted are documented, along with the reasons for non-acceptance of those deliverables. Those deliverables may require a change request for defect repair. The change requests (described in Section 4.3.3.4) are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 5.5.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well for validating deliverables. Requirements documentation. Described in Section 5.2.3.1. The requirements documentation may be updated with the actual results of validation activity. Of particular interest is when the actual results are
  • 215.
    better than therequirement or where a requirement was waived. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix is updated with the results of the validation, including the method used and the outcome. 5.6 CONTROL SCOPE Control Scope is the process of monitoring the status of the project and product scope and managing changes to the scope baseline. The key benefit of this process is that the scope baseline is maintained throughout the project. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 5-17. Figure 5-18 depicts the data flow diagram of the process.
  • 216.
    Controlling the projectscope ensures all requested changes and recommended corrective or preventive actions are processed through the Perform Integrated Change Control process (see Section 4.6). Control Scope is also used to manage the actual changes when they occur and is integrated with the other control processes. The uncontrolled expansion to product or project scope without adjustments to time, cost, and resources is referred to as scope creep. Change is inevitable; therefore, some type of change control process is mandatory for every project. 5.6.1 CONTROL SCOPE: INPUTS 5.6.1.1 PROJECT MANAGEMENT PLAN
  • 217.
    Described in Section4.2.3.1. Project management plan components include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The scope management plan documents how the project and product scope will be controlled. Requirements management plan. Described in Section 5.1.3.2. The requirements management plan describes how the project requirements will be managed. Change management plan. Described in Section 4.2.3.1. The change management plan defines the process for managing change on the project. Configuration management plan. Described in Section 4.2.3.1. The configuration management plan defines those items that are configurable, those items that require formal change control, and the process for controlling changes to such items. Scope baseline. Described in Section 5.4.3.1. The scope baseline is compared to actual results to determine if a change, corrective action, or preventive action is necessary. Performance measurement baseline. Described in Section 4.2.3.1. When using earned value analysis, the performance measurement baseline is compared to actual results to determine if a change, corrective action, or preventive action is necessary. 5.6.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve scope control. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation is used to detect any deviation in the agreed-upon scope for the project or product. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix helps to detect the impact of any change or deviation from the scope baseline on the project objectives.
  • 218.
    It may alsoprovide status of requirements being controlled. 5.6.1.3 WORK PERFORMANCE DATA Work performance data can include the number of change requests received, the number of requests accepted, and the number of deliverables verified, validated, and completed. 5.6.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Control Scope process include but are not limited to: Existing formal and informal scope, control-related policies, procedures, guidelines; and Monitoring and reporting methods and templates to be used. 5.6.2 CONTROL SCOPE: TOOLS AND TECHNIQUES 5.6.2.1 DATA ANALYSIS Data analysis techniques that can be used in the Control Scope process include but are not limited to: Variance analysis. Described in Section 4.5.2.2. Variance analysis is used to compare the baseline to the actual results and determine if the variance is within the threshold amount or if corrective or preventive action is appropriate. Trend analysis. Described in Section 4.5.2.2. Trend analysis examines project performance over time to determine if performance is improving or deteriorating. Important aspects of project scope control include determining the cause and degree of variance relative to the scope baseline (Section 5.4.3.1) and deciding whether corrective or preventive action is required. 5.6.3 CONTROL SCOPE: OUTPUTS 5.6.3.1 WORK PERFORMANCE INFORMATION
  • 219.
    Work performance informationproduced includes correlated and contextualized information on how the project and product scope are performing compared to the scope baseline. It can include the categories of the changes received, the identified scope variances and their causes, how they impact schedule or cost, and the forecast of the future scope performance. 5.6.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. Analysis of project performance may result in a change request to the scope and schedule baselines or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 5.6.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The scope management plan may be updated to reflect a change in how the scope is managed. Scope baseline. Described in Section 5.4.3.1. Changes to the scope baseline are incorporated in response to approved changes in scope, scope statement, the WBS, or the WBS dictionary. In some cases, scope variances can be so severe that a revised scope baseline is needed to provide a realistic basis for performance measurement. Schedule baseline. Described in Section 6.5.3.1. Changes to the schedule baseline are incorporated in response to approved changes in scope, resources, or schedule estimates. In some cases, schedule variances can be so severe that a revised schedule baseline is needed to provide a realistic basis for performance measurement. Cost baseline. Described in Section 7.3.3.1. Changes to the cost baseline are incorporated in response to approved changes in scope, resources, or cost estimates. In some cases, cost variances can be so severe that a revised cost baseline is needed to provide a realistic basis for performance measurement. Performance measurement baseline. Described in Section 4.2.3.1.
  • 220.
    Changes to theperformance measurement baseline are incorporated in response to approved changes in scope, schedule performance, or cost estimates. In some cases, the performance variances can be so severe that a change request is put forth to revise the performance measurement baseline to provide a realistic basis for performance measurement. 5.6.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that are efficient and effective in controlling scope, including causes of variances and corrective actions chosen. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may be updated with additional or changed requirements. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix may be updated to reflect updates in requirement documentation.
  • 221.
    6 PROJECT SCHEDULE MANAGEMENT ProjectSchedule Management includes the processes required to manage the timely completion of the project. The Project Schedule Management processes are: 6.1 Plan Schedule Management—The process of establishing the policies, procedures, and documentation for planning, developing, managing, executing, and controlling the project schedule. 6.2 Define Activities—The process of identifying and documenting the specific actions to be performed to produce the project deliverables. 6.3 Sequence Activities—The process of identifying and documenting relationships among the project activities. 6.4 Estimate Activity Durations—The process of estimating the number of work periods needed to complete individual activities with the estimated resources. 6.5 Develop Schedule—The process of analyzing activity sequences, durations, resource requirements, and schedule constraints to create the project schedule model for project execution and monitoring and controlling. 6.6 Control Schedule—The process of monitoring the status of the project to update the project schedule and manage changes to the schedule baseline. Figure 6-1 provides an overview of the Project Schedule Management processes. The Project Schedule Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 222.
    KEY CONCEPTS FORPROJECT SCHEDULE MANAGEMENT Project scheduling provides a detailed plan that represents how and when the project will deliver the products, services, and results defined in the project scope and serves as a tool for communication, managing stakeholders’ expectations, and as a basis for performance reporting. The project management team selects a scheduling method, such as critical path or an agile approach. Then, the project-specific data, such as the activities, planned dates, durations, resources, dependencies, and constraints, are entered into a scheduling tool to create a schedule model for the project. The result is a project schedule. Figure 6-2 provides a scheduling overview that shows how the
  • 223.
    scheduling method, schedulingtool, and outputs from the Project Schedule Management processes interact to create a schedule model. For smaller projects, defining activities, sequencing activities, estimating activity durations, and developing the schedule model are so tightly linked that they are viewed as a single process that can be performed by a person over a relatively short period of time. These processes are presented here as distinct elements because the tools and techniques for each process are different. Some of these processes are presented more fully in the Practice Standard for Scheduling [2]. When possible, the detailed project schedule should remain flexible throughout the project to adjust for knowledge gained, increased understanding of the risk, and value-added activities.
  • 224.
    TRENDS AND EMERGINGPRACTICES IN PROJECT SCHEDULE MANAGEMENT With high levels of uncertainty and unpredictability in a fast-paced, highly competitive global marketplace where long term scope is difficult to define, it is becoming even more important to have a contextual framework for effective adoption and tailoring of development practices to respond to the changing needs of the environment. Adaptive planning defines a plan but acknowledges that once work starts, the priorities may change and the plan needs to reflect this new knowledge. Some of the emerging practices for project scheduling methods include but are not limited to: Alterative scheduling with a backlog. This is a form of rolling wave planning based on adaptive life cycles, such as the agile approach for product development. The requirements are documented in user stories that are then prioritized and refined just prior to construction, and the product features are developed using time-boxed periods of work. This approach is often used to deliver incremental value to the customer or when multiple teams can concurrently develop a large number of features that have few interconnected dependencies. This scheduling method is appropriate for many projects as indicated by the widespread and growing use of adaptive life cycles for product development. The benefit of this approach is that it welcomes changes throughout the development life cycle. On-demand scheduling. This approach, typically used in a Kanban system, is based on the theory-of-constraints and pull-based scheduling concepts from lean manufacturing to limit a team's work in progress in order to balance demand against the team's delivery throughput. On-demand scheduling does not rely on a schedule that was developed previously for the development of the product or product increments, but rather pulls work from a backlog or intermediate queue of work to be done immediately as resources become available. On-demand scheduling is often used for projects that evolve the product incrementally in operational or sustainment environments, and where tasks may be made relatively similar in size and scope or can be bundled by size and scope. TAILORING CONSIDERATIONS
  • 225.
    Because each projectis unique, the project manager may need to tailor the way Project Schedule Management processes are applied. Considerations for tailoring include but are not limited to: Life cycle approach. What is the most appropriate life cycle approach that allows for a more detailed schedule? Resource availability. What are the factors influencing durations (such as the correlation between available resources and their productivity)? Project dimensions. How will the presence of project complexity, technological uncertainty, product novelty, pace, or progress tracking (such as earned value, percentage complete, red-yellow-green (stop light) indicators) impact the desired level of control? Technology support. Is technology used to develop, record, transmit, receive, and store project schedule model information and is it readily accessible? For more specific information regarding scheduling, refer to the Practice Standard for Scheduling [16]. CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS Adaptive approaches use short cycles to undertake work, review the results, and adapt as necessary. These cycles provide rapid feedback on the approaches and suitability of deliverables, and generally manifest as iterative scheduling and on-demand, pull-based scheduling, as discussed in the section on Key Trends and Emerging Practices in Project Schedule Management. In large organizations, there may be a mixture of small projects and large initiatives requiring long-term roadmaps to manage the development of these programs using scaling factors (e.g., team size, geographical distribution, regulatory compliance, organizational complexity, and technical complexity). To address the full delivery life cycle for larger, enterprise-wide systems, a range of techniques utilizing a predictive approach, adaptive approach, or a hybrid of both, may need to be adopted. The organization may need to combine practices from several core methods, or adopt a method that has already done so, and adopt a few principles and practices of more traditional techniques. The role of the project manager does not change based on managing projects using a predictive development life cycle or managing projects in adaptive environments. However, to be successful in using adaptive approaches, the project manager will need to be familiar with the tools and techniques to
  • 226.
    understand how toapply them effectively. 6.1 PLAN SCHEDULE MANAGEMENT Plan Schedule Management is the process of establishing the policies, procedures, and documentation for planning, developing, managing, executing, and controlling the project schedule. The key benefit of this process is that it provides guidance and direction on how the project schedule will be managed throughout the project. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 6-3. Figure 6-4 depicts the data flow diagram for the process.
  • 227.
    6.1.1 PLAN SCHEDULEMANAGEMENT: INPUTS 6.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter defines the summary milestone schedule that will influence the management of the project schedule. 6.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.3.2.1. Project management plan components include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The scope management plan describes how the scope will be defined and developed, which will provide information on how the schedule will be developed. Development approach. Described in Section 4.2.3.1. The product development approach will help define the scheduling approach, estimating techniques, scheduling tools, and techniques for controlling the schedule. 6.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Schedule Management process include but are not limited to: Organizational culture and structure, Team resource availability and skills and physical resource availability, Scheduling software, Guidelines and criteria for tailoring the organization's set of standard processes and procedures to satisfy the specific needs of the project, and Commercial databases, such as standardized estimating data. 6.1.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Schedule Management process include but are not limited to:
  • 228.
    Historical information andlessons learned repositories; Existing formal and informal schedule development, management- and control-related policies, procedures, and guidelines; Templates and forms; and Monitoring and reporting tools. 6.1.2 PLAN SCHEDULE MANAGEMENT: TOOLS AND TECHNIQUES 6.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in previous, similar projects: Schedule development, management, and control; Scheduling methodologies (e.g., predictive or adaptive life cycle); Scheduling software; and The specific industry for which the project is developed. 6.1.2.2 DATA ANALYSIS A data analysis technique that can be used for this process includes but is not limited to alternatives analysis. Alternatives analysis can include determining which schedule methodology to use, or how to combine various methods on the project. It can also include determining how detailed the schedule needs to be, the duration of waves for rolling wave planning, and how often it should be reviewed and updated. An appropriate balance between the level of detail needed to manage the schedule and the amount of time it takes to keep it up to date needs to be reached for each project. 6.1.2.3 MEETINGS Project teams may hold planning meetings to develop the schedule management plan. Participants at these meetings may include the project manager, the project sponsor, selected project team members, selected stakeholders, anyone with responsibility for schedule planning or execution, and others as needed.
  • 229.
    6.1.3 PLAN SCHEDULEMANAGEMENT: OUTPUTS 6.1.3.1 SCHEDULE MANAGEMENT PLAN The schedule management plan is a component of the project management plan that establishes the criteria and the activities for developing, monitoring, and controlling the schedule. The schedule management plan may be formal or informal, highly detailed, or broadly framed based on the needs of the project, and includes appropriate control thresholds. The schedule management plan can establish the following: Project schedule model development. The scheduling methodology and the scheduling tool to be used in the development of the project schedule model are specified. Release and iteration length. When using an adaptive life cycle, the time-boxed periods for releases, waves, and iterations are specified. Time-boxed periods are durations during which the team works steadily toward completion of a goal. Time-boxing helps to minimize scope creep as it forces the teams to process essential features first, then other features when time permits. Level of accuracy. The level of accuracy specifies the acceptable range used in determining realistic activity duration estimates and may include an amount for contingencies. Units of measure. Each unit of measurement (such as staff hours, staff days, or weeks for time measures, or meters, liters, tons, kilometers, or cubic yards for quantity measures) is defined for each of the resources. Organizational procedures links. The work breakdown structure (WBS) (Section 5.4) provides the framework for the schedule management plan, allowing for consistency with the estimates and resulting schedules. Project schedule model maintenance. The process used to update the status and record progress of the project in the schedule model during the execution of the project is defined. Control thresholds. Variance thresholds for monitoring schedule performance may be specified to indicate an agreed-upon amount of variation to be allowed before some action needs to be taken. Thresholds are typically expressed as percentage deviations from the
  • 230.
    parameters established inthe baseline plan. Rules of performance measurement. Earned value management (EVM) rules or other physical measurement rules of performance measurement are set. For example, the schedule management plan may specify: Rules for establishing percent complete, EVM techniques (e.g., baselines, fixed-formula, percent complete, etc.) to be employed (for more specific information, refer to the Practice Standard for Earned Value Management [17]), and Schedule performance measurements such as schedule variance (SV) and schedule performance index (SPI) used to assess the magnitude of variation to the original schedule baseline. Reporting formats. The formats and frequency for the various schedule reports are defined. 6.2 DEFINE ACTIVITIES Define Activities is the process of identifying and documenting the specific actions to be performed to produce the project deliverables. The key benefit of this process is that it decomposes work packages into schedule activities that provide a basis for estimating, scheduling, executing, monitoring, and controlling the project work. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 6-5. Figure 6-6 depicts the data flow diagram of the process.
  • 231.
    6.2.1 DEFINE ACTIVITIES:INPUTS 6.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan defines the schedule methodology, the duration of waves for rolling wave planning, and the level of detail necessary to manage the work. Scope baseline. Described in Section 5.4.3.1. The project WBS, deliverables, constraints, and assumptions documented in the scope baseline are considered explicitly while defining activities. 6.2.1.2 ENTERPRISE ENVIRONMENTAL FACTORS Enterprise environmental factors that influence the Define Activities process include but are not limited to: Organizational cultures and structure,
  • 232.
    Published commercial informationfrom commercial databases, and Project management information system (PMIS). 6.2.1.3 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Define Activities process include but are not limited to: Lessons learned repository containing historical information regarding activity lists used by previous similar projects, Standardized processes, Templates that contain a standard activity list or a portion of an activity list from a previous project, and Existing formal and informal activity planning-related policies, procedures, and guidelines, such as the scheduling methodology, that are considered in developing the activity definitions. 6.2.2 DEFINE ACTIVITIES: TOOLS AND TECHNIQUES 6.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge of similar past projects and the work being performed. 6.2.2.2 DECOMPOSITION Described in Section 5.4.2.2. Decomposition is a technique used for dividing and subdividing the project scope and project deliverables into smaller, more manageable parts. Activities represent the effort needed to complete a work package. The Define Activities process defines the final outputs as activities rather than deliverables, as done in the Create WBS process (Section 5.4). The activity list, WBS, and WBS dictionary can be developed either sequentially or concurrently, with the WBS and WBS dictionary used as the basis for development of the final activity list. Each work package within the WBS is decomposed into the activities required to produce the work package deliverables. Involving team members in the decomposition can lead to better and more accurate results.
  • 233.
    6.2.2.3 ROLLING WAVEPLANNING Rolling wave planning is an iterative planning technique in which the work to be accomplished in the near term is planned in detail, while work further in the future is planned at a higher level. It is a form of progressive elaboration applicable to work packages, planning packages, and release planning when using an agile or waterfall approach. Therefore, work can exist at various levels of detail depending on where it is in the project life cycle. During early strategic planning when information is less defined, work packages may be decomposed to the known level of detail. As more is known about the upcoming events in the near term, work packages can be decomposed into activities. 6.2.2.4 MEETINGS Meetings may be face-to-face, virtual, formal, or informal. Meetings may be held with team members or subject matter experts to define the activities needed to complete the work. 6.2.3 DEFINE ACTIVITIES: OUTPUTS 6.2.3.1 ACTIVITY LIST The activity list includes the schedule activities required on the project. For projects that use rolling wave planning or agile techniques, the activity list will be updated periodically as the project progresses. The activity list includes an activity identifier and a scope of work description for each activity in sufficient detail to ensure that project team members understand what work is required to be completed. 6.2.3.2 ACTIVITY ATTRIBUTES Activity attributes extend the description of the activity by identifying multiple components associated with each activity. The components for each activity evolve over time. During the initial stages of the project, they include the unique activity identifier (ID), WBS ID, and activity label or name. When completed, they may include activity descriptions, predecessor activities, successor activities, logical relationships, leads and lags (Section 6.3.2.3), resource requirements, imposed dates, constraints, and assumptions. Activity attributes can be used to identify the place where the work has to be performed, the project calendar the activity is assigned to, and the type of effort involved.
  • 234.
    Activity attributes areused for schedule development and for selecting, ordering, and sorting the planned schedule activities in various ways within reports 6.2.3.3 MILESTONE LIST A milestone is a significant point or event in a project. A milestone list identifies all project milestones and indicates whether the milestone is mandatory, such as those required by contract, or optional, such as those based on historical information. Milestones have zero duration because they represent a significant point or event. 6.2.3.4 CHANGE REQUESTS Described in Section 4.3.3.4. Once the project has been baselined, the progressive elaboration of deliverables into activities may reveal work that was not initially part of the project baselines. This may result in a change request. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 6.2.3.5 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Schedule baseline. Described in Section 6.5.3.1. Throughout the project, work packages are progressively elaborated into activities. This process may reveal work that was not part of the initial schedule baseline, necessitating a change to delivery dates or other significant schedule milestones that are part of the schedule baseline. Cost baseline. Described in Section 7.3.3.1. Changes to the cost baseline are incorporated in response to approved changes in schedule activities. 6.3 SEQUENCE ACTIVITIES Sequence Activities is the process of identifying and documenting relationships among the project activities. The key benefit of this process is that it defines the logical sequence of work to obtain the greatest efficiency given all project constraints. This process is performed throughout the project. The inputs,
  • 235.
    tools and techniques,and outputs of this process are depicted in Figure 6-7. Figure 6-8 depicts the data flow diagram of the process. Every activity except the first and last should be connected to at least one predecessor and at least one successor activity with an appropriate logical relationship. Logical relationships should be designed to create a realistic project schedule. It may be necessary to use lead or lag time between activities to support a realistic and achievable project schedule. Sequencing can be
  • 236.
    performed by usingproject management software or by using manual or automated techniques. The Sequence Activities process concentrates on converting the project activities from a list to a diagram to act as a first step to publish the schedule baseline. 6.3.1 SEQUENCE ACTIVITIES: INPUTS 6.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan defines the method used and the level of accuracy along with other criteria required to sequence activities. Scope baseline. Described in Section 5.4.3.1. The project WBS, deliverables, constraints, and assumptions documented in the scope baseline are considered explicitly while sequencing activities. 6.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity attributes may describe a necessary sequence of events or defined predecessor or successor relationships, as well as defined lead and lag and logical relationships between the activities. Activity list. Described in Section 6.2.3.1. The activity list contains all schedule activities required on the project that are to be sequenced. Dependencies and other constraints for these activities can influence the sequencing of the activities. Assumption log. Described in Section 4.1.3.2. Assumptions and constraints recorded in the assumption log may influence the way activities are sequenced, the relationship between activities, and the need for leads and lags, and may give rise to individual project risks that may impact the project schedule. Milestone list. Described in Section 6.2.3.3. The milestone list may
  • 237.
    have scheduled datesfor specific milestones, which may influence the way activities are sequenced. 6.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Sequence Activities process include but are not limited to: Government or industry standards, Project management information system (PMIS), Scheduling tools, and Organization work authorization systems. 6.3.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Sequence Activities process include but are not limited to: Portfolio and program plans and project dependencies and relationships; Existing formal and informal activity planning-related policies, procedures, and guidelines, such as the scheduling methodology that is considered in developing logical relationships; Templates that can be used to expedite the preparation of networks for project activities. Related activity attributes information in templates can also contain additional descriptive information useful in sequencing activities; and Lessons learned repository containing historical information that can help optimize the sequencing process. 6.3.2 SEQUENCE ACTIVITIES: TOOLS AND TECHNIQUES 6.3.2.1 PRECEDENCE DIAGRAMMING METHOD The precedence diagramming method (PDM) is a technique used for constructing a schedule model in which activities are represented by nodes and are graphically linked by one or more logical relationships to show the sequence in which the activities are to be performed.
  • 238.
    PDM includes fourtypes of dependencies or logical relationships. A predecessor activity is an activity that logically comes before a dependent activity in a schedule. A successor activity is a dependent activity that logically comes after another activity in a schedule. These relationships are defined below and are illustrated in Figure 6-9: Finish-to-start (FS). A logical relationship in which a successor activity cannot start until a predecessor activity has finished. For example, installing the operating system on a PC (successor) cannot start until the PC hardware is assembled (predecessor). Finish-to-finish (FF). A logical relationship in which a successor activity cannot finish until a predecessor activity has finished. For example, writing a document (predecessor) is required to finish before editing the document (successor) can finish. Start-to-start (SS). A logical relationship in which a successor activity cannot start until a predecessor activity has started. For example, level concrete (successor) cannot begin until pour foundation (predecessor) begins. Start-to-finish (SF). A logical relationship in which a successor activity cannot finish until a predecessor activity has started. For example, a new accounts payable system (successor) has to start before the old accounts payable system can be shut down (predecessor). In PDM, FS is the most commonly used type of precedence relationship. The SF relationship is very rarely used, but is included to present a complete list of the PDM relationship types. Two activities can have two logical relationships at the same time (for example, SS and FF). Multiple relationships between the same activities are not recommended, so a decision has to be made to select the relationship with the highest impact. Closed loops are also not recommended in logical relationships.
  • 239.
    6.3.2.2 DEPENDENCY DETERMINATIONAND INTEGRATION Dependencies may be characterized by the following attributes: mandatory or discretionary, internal or external (as described below). Dependency has four attributes, but two can be applicable at the same time in the following ways: mandatory external dependencies, mandatory internal dependencies, discretionary external dependencies, or discretionary internal dependencies. Mandatory dependencies. Mandatory dependencies are those that are legally or contractually required or inherent in the nature of the work. Mandatory dependencies often involve physical limitations, such as on a construction project, where it is impossible to erect the superstructure until after the foundation has been built, or on an electronics project, where a prototype has to be built before it can be tested. Mandatory dependencies are sometimes referred to as hard logic or hard dependencies. Technical dependencies may not be mandatory. The project team determines which dependencies are mandatory during the process of sequencing the activities. Mandatory dependencies should not be confused with assigning schedule constraints in the scheduling tool. Discretionary dependencies. Discretionary dependencies are sometimes referred to as preferred logic, preferential logic, or soft
  • 240.
    logic. Discretionary dependenciesare established based on knowledge of best practices within a particular application area or some unusual aspect of the project where a specific sequence is desired, even though there may be other acceptable sequences. For example, generally accepted best practices recommend that during construction, the electrical work should start after finishing the plumbing work. This order is not mandatory and both activities may occur at the same time (in parallel), but performing the activities in sequential order reduces the overall project risk. Discretionary dependencies should be fully documented since they can create arbitrary total float values and can limit later scheduling options. When fast tracking techniques are employed, these discretionary dependencies should be reviewed and considered for modification or removal. The project team determines which dependencies are discretionary during the process of sequencing the activities. External dependencies. External dependencies involve a relationship between project activities and non-project activities. These dependencies are usually outside of the project team's control. For example, the testing activity in a software project may be dependent on the delivery of hardware from an external source, or governmental environmental hearings may need to be held before site preparation can begin on a construction project. The project management team determines which dependencies are external during the process of sequencing the activities. Internal dependencies. Internal dependencies involve a precedence relationship between project activities and are generally inside the project team's control. For example, if the team cannot test a machine until they assemble it, there is an internal mandatory dependency. The project management team determines which dependencies are internal during the process of sequencing the activities. 6.3.2.3 LEADS AND LAGS A lead is the amount of time a successor activity can be advanced with respect to a predecessor activity. For example, on a project to construct a new office building, the landscaping could be scheduled to start 2 weeks prior to the scheduled punch list completion. This would be shown as a finish-to-start with a 2-week lead as shown in Figure 6-10. Lead is often represented as a negative value for lag in scheduling software.
  • 241.
    A lag isthe amount of time a successor activity will be delayed with respect to a predecessor activity. For example, a technical writing team may begin editing the draft of a large document 15 days after they begin writing it. This can be shown as a start-to-start relationship with a 15-day lag as shown in Figure 6-10. Lag can also be represented in project schedule network diagrams as shown in Figure 6-11 in the relationship between activities H and I (as indicated by the nomenclature SS+10 (start-to-start plus 10 days lag) even though the offset is not shown relative to a timescale). The project management team determines the dependencies that may require a lead or a lag to accurately define the logical relationship. The use of leads and lags should not replace schedule logic. Also, duration estimates do not include any leads or lags. Activities and their related assumptions should be documented.
  • 242.
    6.3.2.4 PROJECT MANAGEMENTINFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems includes scheduling software that has the capability to help plan, organize, and adjust the sequence of the activities; insert the logical relationships, lead and lag values; and differentiate the different types of dependencies. 6.3.3 SEQUENCE ACTIVITIES: OUTPUTS 6.3.3.1 PROJECT SCHEDULE NETWORK DIAGRAMS A project schedule network diagram is a graphical representation of the logical relationships, also referred to as dependencies, among the project schedule activities. Figure 6-11 illustrates a project schedule network diagram. A project schedule network diagram is produced manually or by using project management software. It can include full project details, or have one or more summary activities. A summary narrative can accompany the diagram and describe the basic approach used to sequence the activities. Any unusual activity sequences within the network should be fully described within the narrative. Activities that have multiple predecessor activities indicate a path
  • 243.
    convergence. Activities thathave multiple successor activities indicate a path divergence. Activities with divergence and convergence are at greater risk as they are affected by multiple activities or can affect multiple activities. Activity I is called a path convergence, as it has more than one predecessor, while activity K is called a path divergence, as it has more than one successor. 6.3.3.2 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity attributes may describe a necessary sequence of events or defined predecessor or successor relationships, as well as defined lead and lag and logical relationships between the activities. Activity list. Described in Section 6.2.3.1. The activity list may be impacted by the change in relationships among the project activities during the sequencing activities. Assumption log. Described in Section 4.1.3.2. Assumptions and constraints recorded in the assumption log may need to be updated based on the sequencing, relationship determination, and leads and lags, and may give rise to individual project risks that may impact the project schedule. Milestone list. Described in Section 6.2.3.3. The scheduled dates for specific milestones may be impacted by changes in relationships among the project activities during the sequencing activities. 6.4 ESTIMATE ACTIVITY DURATIONS Estimate Activity Durations is the process of estimating the number of work periods needed to complete individual activities with estimated resources. The key benefit of this process is that it provides the amount of time each activity will take to complete. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 6- 12. Figure 6-13 depicts the data flow diagram of the process.
  • 244.
    Estimating activity durationsuses information from the scope of work,
  • 245.
    required resource typesor skill levels, estimated resource quantities, and resource calendars. Other factors that may influence the duration estimates include constraints imposed on the duration, effort involved, or type of resources (e.g., fixed duration, fixed effort or work, fixed number of resources), as well as the schedule network analysis technique used. The inputs for the estimates of duration originate from the person or group on the project team who is most familiar with the nature of the work in the specific activity. The duration estimate is progressively elaborated, and the process considers the quality and availability of the input data. For example, as more detailed and precise data are available about the project engineering and design work, the accuracy and quality of the duration estimates improve. The Estimate Activity Durations process requires an estimation of the amount of work effort required to complete the activity and the amount of available resources estimated to complete the activity. These estimates are used to approximate the number of work periods (activity duration) needed to complete the activity using the appropriate project and resource calendars. In many cases, the number of resources that are expected to be available to accomplish an activity, along with the skill proficiency of those resources, may determine the activity's duration. A change to a driving resource allocated to the activity will usually have an effect on the duration, but this is not a simple “straight-line” or linear relationship. Sometimes, the intrinsic nature of the work (i.e., constraints imposed on the duration, effort involved, or number of resources) will take a predetermined amount of time to complete regardless of the resource allocation (e.g., a 24-hour stress test). Other factors for consideration when estimating duration include: Law of diminishing returns. When one factor (e.g., resource) used to determine the effort required to produce a unit of work is increased while all other factors remain fixed, a point will eventually be reached at which additions of that one factor start to yield progressively smaller or diminishing increases in output. Number of resources. Increasing the number of resources to twice the original number of the resources does not always reduce the time by half, as it may increase extra duration due to risk, and at some point adding too many resources to the activity may increase duration due to knowledge transfer, learning curve, additional coordination, and other factors involved. Advances in technology. This may also play an important role in
  • 246.
    determining duration estimates.For example, an increase in the output of a manufacturing plant may be achieved by procuring the latest advances in technology, which may impact duration and resource needs. Motivation of staff. The project manager also needs to be aware of Student Syndrome—or procrastination—when people start to apply themselves only at the last possible moment before the deadline, and Parkinson's Law where work expands to fill the time available for its completion. All data and assumptions that support duration estimating are documented for each activity duration estimate. 6.4.1 ESTIMATE ACTIVITY DURATIONS: INPUTS 6.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan defines the method used, as well as the level of accuracy and other criteria required to estimate activity durations. Scope baseline. Described in Section 5.4.3.1. The scope baseline includes the WBS dictionary, which contains technical details that can influence the effort and duration estimates. 6.4.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity attributes may describe defined predecessor or successor relationships, as well as defined lead and lag and logical relationships between the activities that may impact duration estimates. Activity list. Described in Section 6.2.3.1. The activity list contains all schedule activities required on the project, which are to be estimated.
  • 247.
    Dependencies and otherconstraints for these activities can influence the duration estimates. Assumption log. Described in Section 4.1.3.2. Assumptions and constraints recorded in the assumption log may give rise to individual project risks that may impact the project schedule. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to effort and duration estimating can be applied to later phases in the project to improve the accuracy and precision of effort and duration estimates. Milestone list. Described in Section 6.2.3.3. The milestone list may have scheduled dates for specific milestones that may impact the duration estimates. Project team assignments. Described in Section 9.3.3.1. The project is staffed when the appropriate people have been assigned to the team. Resource breakdown structure. Described in Section 9.2.3.3. The resource breakdown structure provides a hierarchical structure of the identified resources by resource category and resource type. Resource calendars. Described in Section 9.2.1.2. The resource calendars influence the duration of schedule activities due to the availability of specific resources, type of resources, and resources with specific attributes. Resource calendars specify when and how long identified project resources will be available during the project. Resource requirements. Described in Section 9.2.3.1. The estimated activity resource requirements will have an effect on the duration of the activity, since the level to which the resources assigned to the activity meet the requirements will significantly influence the duration of most activities. For example, if additional or lower-skilled resources are assigned to an activity, there may be reduced efficiency or productivity due to increased communication, training, and coordination needs leading to a longer duration estimate. Risk register. Described in Section 11.2.3.1. Individual project risks may impact resource selection and availability. Updates to the risk register are included with project documents updates, described in Section 11.5.3.2, from Plan Risk Responses. 6.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS
  • 248.
    The enterprise environmentalfactors that can influence the Estimate Activity Durations process include but are not limited to: Duration estimating databases and other reference data, Productivity metrics, Published commercial information, and Location of team members. 6.4.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Estimate Activity Durations process include but are not limited to: Historical duration information, Project calendars, Estimating policies, Scheduling methodology, and Lessons learned repository. 6.4.2 ESTIMATE ACTIVITY DURATIONS: TOOLS AND TECHNIQUES 6.4.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Schedule development, management, and control; Expertise in estimating; and Discipline or application knowledge. 6.4.2.2 ANALOGOUS ESTIMATING Analogous estimating is a technique for estimating the duration or cost of an activity or a project using historical data from a similar activity or project. Analogous estimating uses parameters from a previous, similar project, such as duration, budget, size, weight, and complexity, as the basis for estimating the
  • 249.
    same parameter ormeasure for a future project. When estimating durations, this technique relies on the actual duration of previous, similar projects as the basis for estimating the duration of the current project. It is a gross value estimating approach, sometimes adjusted for known differences in project complexity. Analogous duration estimating is frequently used to estimate project duration when there is a limited amount of detailed information about the project. Analogous estimating is generally less costly and less time-consuming than other techniques, but it is also less accurate. Analogous duration estimates can be applied to a total project or to segments of a project and may be used in conjunction with other estimating methods. Analogous estimating is most reliable when the previous activities are similar in fact and not just in appearance, and the project team members preparing the estimates have the needed expertise. 6.4.2.3 PARAMETRIC ESTIMATING Parametric estimating is an estimating technique in which an algorithm is used to calculate cost or duration based on historical data and project parameters. Parametric estimating uses a statistical relationship between historical data and other variables (e.g., square footage in construction) to calculate an estimate for activity parameters, such as cost, budget, and duration. Durations can be quantitatively determined by multiplying the quantity of work to be performed by the number of labor hours per unit of work. For example, duration on a design project is estimated by the number of drawings multiplied by the number of labor hours per drawing, or on a cable installation, the meters of cable multiplied by the number of labor hours per meter. If the assigned resource is capable of installing 25 meters of cable per hour, the duration required to install 1,000 meters is 40 hours (1,000 meters divided by 25 meters per hour). This technique can produce higher levels of accuracy depending on the sophistication and underlying data built into the model. Parametric schedule estimates can be applied to a total project or to segments of a project, in conjunction with other estimating methods. 6.4.2.4 THREE-POINT ESTIMATING The accuracy of single-point duration estimates may be improved by considering estimation uncertainty and risk. Using three-point estimates helps define an approximate range for an activity's duration:
  • 250.
    Most likely (tM).This estimate is based on the duration of the activity, given the resources likely to be assigned, their productivity, realistic expectations of availability for the activity, dependencies on other participants, and interruptions. Optimistic (tO). The activity duration based on analysis of the best- case scenario for the activity. Pessimistic (tP). The duration based on analysis of the worst-case scenario for the activity. Depending on the assumed distribution of values within the range of the three estimates, the expected duration, tE, can be calculated. One commonly used formula is triangular distribution: tE = (tO + tM + tP) / 3. Triangular distribution is used when there is insufficient historical data or when using judgmental data. Duration estimates based on three points with an assumed distribution provide an expected duration and clarify the range of uncertainty around the expected duration. 6.4.2.5 BOTTOM-UP ESTIMATING Bottom-up estimating is a method of estimating project duration or cost by aggregating the estimates of the lower-level components of the WBS. When an activity's duration cannot be estimated with a reasonable degree of confidence, the work within the activity is decomposed into more detail. The detail durations are estimated. These estimates are then aggregated into a total quantity for each of the activity's durations. Activities may or may not have dependencies between them that can affect the application and use of resources. If there are dependencies, this pattern of resource usage is reflected and documented in the estimated requirements of the activity. 6.4.2.6 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Alternatives analysis. Alternatives analysis is used to compare various levels of resource capability or skills; scheduling compression techniques (described in Section 6.5.2.6); different tools (manual versus automated); and make, rent, or buy decisions regarding the
  • 251.
    resources. This allowsthe team to weigh resource, cost, and duration variables to determine an optimal approach for accomplishing project work. Reserve analysis. Reserve analysis is used to determine the amount of contingency and management reserve needed for the project. Duration estimates may include contingency reserves, sometimes referred to as schedule reserves, to account for schedule uncertainty. Contingency reserves are the estimated duration within the schedule baseline, which is allocated for identified risks that are accepted. Contingency reserves are associated with the known-unknowns, which may be estimated to account for this unknown amount of rework. The contingency reserve may be a percentage of the estimated activity duration or a fixed number of work periods. Contingency reserves may be separated from the individual activities and aggregated. As more precise information about the project becomes available, the contingency reserve may be used, reduced, or eliminated. Contingency should be clearly identified in the schedule documentation. Estimates may also be produced for the amount of management reserve of schedule for the project. Management reserves are a specified amount of the project budget withheld for management control purposes and are reserved for unforeseen work that is within scope of the project. Management reserves are intended to address the unknown-unknowns that can affect a project. Management reserve is not included in the schedule baseline, but it is part of the overall project duration requirements. Depending on contract terms, use of management reserves may require a change to the schedule baseline. 6.4.2.7 DECISION MAKING Described in Section 5.2.2.4. Decision-making techniques that can be used in this process include but are not limited to voting. One variation of the voting method that is often used in agile-based projects is called the fist of five (also called fist to five). In this technique, the project manager asks the team to show their level of support for a decision by holding up a closed fist (indicating no support) up to five fingers (indicating full support). If a team member holds up fewer than three fingers, the team member is given the opportunity to discuss any objections with the team. The project manager continues the fist-of-five process until the team achieves consensus (everyone holds up three or more fingers) or agrees to move on to the next decision.
  • 252.
    6.4.2.8 MEETINGS The projectteam may hold meetings to estimate activity durations. When using an agile approach, it is necessary to conduct sprint or iteration planning meetings to discuss prioritized product backlog items (user stories) and decide which of these items the team will commit to work on in the upcoming iteration. The team breaks down user stories to low-level tasks, with estimates in hours, and then validates that the estimates are achievable based on team capacity over the duration (iteration). This meeting is usually held on the first day of the iteration and is attended by the product owner, the Scrum team, and the project manager. The outcome of the meeting includes an iteration backlog, as well as assumptions, concerns, risks, dependencies, decisions, and actions. 6.4.3 ESTIMATE ACTIVITY DURATIONS: OUTPUTS 6.4.3.1 DURATION ESTIMATES Duration estimates are quantitative assessments of the likely number of time periods that are required to complete an activity, a phase, or a project. Duration estimates do not include any lags as described in Section 6.3.2.3. Duration estimates may include some indication of the range of possible results. For example: A range of 2 weeks ± 2 days, which indicates that the activity will take at least 8 days and not more than 12 (assuming a 5-day work week); or A 15% probability of exceeding 3 weeks, which indicates a high probability—85%—that the activity will take 3 weeks or less. 6.4.3.2 BASIS OF ESTIMATES The amount and type of additional details supporting the duration estimate vary by application area. Regardless of the level of detail, the supporting documentation should provide a clear and complete understanding of how the duration estimate was derived. Supporting detail for duration estimates may include: Documentation of the basis of the estimate (i.e., how it was developed),
  • 253.
    Documentation of allassumptions made, Documentation of any known constraints, Indication of the range of possible estimates (e.g., ±10%) to indicate that the duration is estimated between a range of values), Indication of the confidence level of the final estimate, and Documentation of individual project risks influencing this estimate. 6.4.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity duration estimates produced during this process are documented as part of the activity attributes. Assumption log. Described in Section 4.1.3.2. This includes assumptions made in developing the duration estimate, such as resource skill levels and availability, as well as a basis of estimates for durations. Additionally, constraints arising out of the scheduling methodology and scheduling tool are also documented. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were efficient and effective in developing effort and duration estimates. 6.5 DEVELOP SCHEDULE Develop Schedule is the process of analyzing activity sequences, durations, resource requirements, and schedule constraints to create a schedule model for project execution and monitoring and controlling. The key benefit of this process is that it generates a schedule model with planned dates for completing project activities. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 6-14. Figure 6-15 depicts the data flow diagram of the process.
  • 255.
    Developing an acceptableproject schedule is an iterative process. The schedule model is used to determine the planned start and finish dates for project activities and milestones based on the best available information. Schedule development can require the review and revision of duration estimates, resource estimates, and schedule reserves to establish an approved project schedule that can serve as a baseline to track progress. Key steps include defining the project milestones, identifying and sequencing activities, and estimating durations. Once the activity start and finish dates have been determined, it is common to have the project staff assigned to the activities review their assigned activities. The staff confirms that the start and finish dates present no conflict with resource calendars or assigned activities on other projects or tasks and thus are still valid. The schedule is then analyzed to determine conflicts with logical relationships and if resource leveling is required before the schedule is approved and baselined. Revising and maintaining the project schedule model to sustain a
  • 256.
    realistic schedule continuesthroughout the duration of the project, as described in Section 6.7. For more specific information regarding scheduling, refer to the Practice Standard for Scheduling. 6.5.1 DEVELOP SCHEDULE: INPUTS 6.5.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan identifies the scheduling method and tool used to create the schedule and how the schedule is to be calculated. Scope baseline. Described in Section 5.4.3.1. The scope statement, WBS, and WBS dictionary have details about the project deliverables that are considered when building the schedule model. 6.5.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. The activity attributes provide the details used to build the schedule model. Activity list. Described in Section 6.2.3.1. The activity list identifies the activities that will be included in the schedule model. Assumption log. Described in Section 4.1.3.2. Assumptions and constraints recorded in the assumption log may give rise to individual project risks that may impact the project schedule. Basis of estimates. Described in Section 6.4.3.2. The amount and type of additional details supporting the duration estimate vary by application area. Regardless of the level of detail, the supporting documentation should provide a clear and complete understanding of how the duration estimate was derived. Duration estimates. Described in Section 6.4.3.1. The duration estimates contain the quantitative assessments of the likely number of
  • 257.
    work periods thatwill be required to complete an activity. This will be used to calculate the schedule. Lessons learned. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to developing the schedule model can be applied to later phases in the project to improve the validity of the schedule model. Milestone list. Described in Section 6.2.3.3. The milestone list has scheduled dates for specific milestones. Project schedule network diagrams. Described in Section 6.3.3.1. The project schedule network diagrams contain the logical relationships of predecessors and successors that will be used to calculate the schedule. Project team assignments. Described in Section 9.3.3.1. The project team assignments specify which resources are assigned to each activity. Resource calendars. Described in Sections 9.2.1.2. The resource calendars contain information on the availability of resources during the project. Resource requirements. Described in Section 9.2.3.1. The activity resource requirements identify the types and quantities of resources required for each activity used to create the schedule model. Risk register. Described in Section 11.2.3.1. The risk register provides the details of all identified risks, and their characteristics, that affect the schedule model. Risk information relevant to the schedule is reflected in schedule reserves using the expected or mean risk impact. 6.5.1.3 AGREEMENTS Described in Section 12.2.3.2. Vendors may have an input to the project schedule as they develop the details of how they will perform the project work to meet contractual commitments. 6.5.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Develop Schedule process include but are not limited to: Government or industry standards, and Communication channels.
  • 258.
    6.5.1.5 ORGANIZATIONAL PROCESSASSETS The organizational process assets that can influence the Develop Schedule process include but are not limited to: Scheduling methodology containing the policies governing schedule model development and maintenance, and Project calendar(s). 6.5.2 DEVELOP SCHEDULE: TOOLS AND TECHNIQUES 6.5.2.1 SCHEDULE NETWORK ANALYSIS Schedule network analysis is the overarching technique used to generate the project schedule model. It employs several other techniques such as critical path method (described in Section 6.5.2.2), resource optimization techniques (described in Section 6.5.2.3), and modeling techniques (described in Section 6.5.2.4). Additional analysis includes but is not limited to: Assessing the need to aggregate schedule reserves to reduce the probability of a schedule slip when multiple paths converge at a single point in time or when multiple paths diverge from a single point in time, to reduce the probability of a schedule slip. Reviewing the network to see if the critical path has high-risk activities or long lead items that would necessitate use of schedule reserves or the implementation of risk responses to reduce the risk on the critical path. Schedule network analysis is an iterative process that is employed until a viable schedule model is developed. 6.5.2.2 CRITICAL PATH METHOD The critical path method is used to estimate the minimum project duration and determine the amount of schedule flexibility on the logical network paths within the schedule model. This schedule network analysis technique calculates the early start, early finish, late start, and late finish dates for all activities without regard for any resource limitations by performing a forward and backward pass analysis through the schedule network, as shown in Figure 6-16. In this example, the longest path includes activities A, C, and D, and therefore the sequence of A-
  • 259.
    C-D is thecritical path. The critical path is the sequence of activities that represents the longest path through a project, which determines the shortest possible project duration. The longest path has the least total float—usually zero. The resulting early and late start and finish dates are not necessarily the project schedule; rather they indicate the time periods within which the activity could be executed, using the parameters entered in the schedule model for activity durations, logical relationships, leads, lags, and other known constraints. The critical path method is used to calculate the critical path(s) and the amount of total and free float or schedule flexibility on the logical network paths within the schedule model. On any network path, the total float or schedule flexibility is measured by the amount of time that a schedule activity can be delayed or extended from its early start date without delaying the project finish date or violating a schedule constraint. A critical path is normally characterized by zero total float on the critical path. As implemented with the precedence diagramming method sequencing, critical paths may have positive, zero, or negative total float depending on the constraints applied. Positive total float is caused when the backward pass is calculated from a schedule constraint that is later than the early finish date that has been calculated during forward pass calculation. Negative total float is caused when a constraint on the late dates is violated by duration and logic. Negative float analysis is a technique that helps to find possible accelerated ways of bringing a delayed schedule back on track. Schedule networks may have multiple near-critical paths. Many software packages allow the user to define the parameters used to determine the critical path(s). Adjustments to activity durations (when more resources or less scope can be arranged), logical relationships (when the relationships were discretionary to begin with), leads and lags, or other schedule constraints may be necessary to produce network paths with a zero or positive total float. Once the total float and the free float have been calculated, the free float is the amount of time that a schedule activity can be delayed without delaying the early start date of any successor or violating a schedule constraint. For example the free float for Activity B, in Figure 6-16, is 5 days.
  • 260.
    6.5.2.3 RESOURCE OPTIMIZATION Resourceoptimization is used to adjust the start and finish dates of activities to adjust planned resource use to be equal to or less than resource availability. Examples of resource optimization techniques that can be used to adjust the schedule model due to demand and supply of resources include but are not limited to: Resource leveling. A technique in which start and finish dates are adjusted based on resource constraints with the goal of balancing the demand for resources with the available supply. Resource leveling can be used when shared or critically required resources are available only at certain times or in limited quantities, or are over-allocated, such as when a resource has been assigned to two or more activities during the same time period (as shown in Figure 6-17), or there is a need to keep resource usage at a constant level. Resource leveling can often cause the original critical path to change. Available float is used for leveling resources. Consequently, the critical path through the project schedule may change. Resource smoothing. A technique that adjusts the activities of a
  • 261.
    schedule model suchthat the requirements for resources on the project do not exceed certain predefined resource limits. In resource smoothing, as opposed to resource leveling, the project's critical path is not changed and the completion date may not be delayed. In other words, activities may only be delayed within their free and total float. Resource smoothing may not be able to optimize all resources. 6.5.2.4 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: What-if scenario analysis. What-if scenario analysis is the process of evaluating scenarios in order to predict their effect, positive or
  • 262.
    negative, on projectobjectives. This is an analysis of the question, “What if the situation represented by scenario X happens?” A schedule network analysis is performed using the schedule to compute the different scenarios, such as delaying a major component delivery, extending specific engineering durations, or introducing external factors, such as a strike or a change in the permit process. The outcome of the what-if scenario analysis can be used to assess the feasibility of the project schedule under different conditions, and in preparing schedule reserves and response plans to address the impact of unexpected situations. Simulation. Simulation models the combined effects of individual project risks and other sources of uncertainty to evaluate their potential impact on achieving project objectives. The most common simulation technique is Monte Carlo analysis (see Section 11.4.2.5), in which risks and other sources of uncertainty are used to calculate possible schedule outcomes for the total project. Simulation involves calculating multiple work package durations with different sets of activity assumptions, constraints, risks, issues, or scenarios using probability distributions and other representations of uncertainty (see Section 11.4.2.4). Figure 6-18 shows a probability distribution for a project with the probability of achieving a certain target date (i.e., project finish date). In this example, there is a 10% probability that the project will finish on or before the target date of May 13, while there is a 90% probability of completing the project by May 28.
  • 263.
    For more informationon how Monte Carlo simulation is used for schedule models, see the Practice Standard for Scheduling. 6.5.2.5 LEADS AND LAGS Described in Section 6.3.2.3. Leads and lags are refinements applied during network analysis to develop a viable schedule by adjusting the start time of the successor activities. Leads are used in limited circumstances to advance a successor activity with respect to the predecessor activity, and lags are used in limited circumstances where processes require a set period of time to elapse between the predecessors and successors without work or resource impact. 6.5.2.6 SCHEDULE COMPRESSION Schedule compression techniques are used to shorten or accelerate the schedule duration without reducing the project scope in order to meet schedule constraints, imposed dates, or other schedule objectives. A helpful technique is
  • 264.
    the negative floatanalysis. The critical path is the one with the least float. Due to violating a constraint or imposed date, the total float can become negative. Schedule compression techniques are compared in Figure 6-19 and include: Crashing. A technique used to shorten the schedule duration for the least incremental cost by adding resources. Examples of crashing include approving overtime, bringing in additional resources, or paying to expedite delivery to activities on the critical path. Crashing works only for activities on the critical path where additional resources will shorten the activity's duration. Crashing does not always produce a viable alternative and may result in increased risk and/or cost. Fast tracking. A schedule compression technique in which activities or phases normally done in sequence are performed in parallel for at least a portion of their duration. An example is constructing the foundation for a building before completing all of the architectural drawings. Fast tracking may result in rework and increased risk. Fast tracking only works when activities can be overlapped to shorten the project duration on the critical path. Using leads in case of schedule acceleration usually increases coordination efforts between the activities concerned and increases quality risk. Fast tracking may also increase project costs.
  • 265.
    6.5.2.7 PROJECT MANAGEMENTINFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems include scheduling software that expedites the process of building a schedule model by generating start and finish dates based on the inputs of activities, network diagrams, resources, and activity durations. 6.5.2.8 AGILE RELEASE PLANNING Agile release planning provides a high-level summary timeline of the release schedule (typically 3 to 6 months) based on the product roadmap and the product vision for the product's evolution. Agile release planning also determines the number of iterations or sprints in the release, and allows the product owner and team to decide how much needs to be developed and how long it will take to have a releasable product based on business goals, dependencies, and impediments. Since features represent value to the customer, the timeline provides a more easily understood project schedule as it defines which feature will be available at the end of each iteration, which is exactly the depth of information the customer is looking for.
  • 266.
    Figure 6-20 showsthe relationship among product vision, product roadmap, release planning, and iteration planning. 6.5.3 DEVELOP SCHEDULE: OUTPUTS 6.5.3.1 SCHEDULE BASELINE A schedule baseline is the approved version of a schedule model that can be changed only through formal change control procedures and is used as a basis for comparison to actual results. It is accepted and approved by the appropriate stakeholders as the schedule baseline with baseline start dates and baseline finish dates. During monitoring and controlling, the approved baseline dates are compared to the actual start and finish dates to determine if variances have occurred. The schedule baseline is a component of the project management plan. 6.5.3.2 PROJECT SCHEDULE The project schedule is an output of a schedule model that presents linked
  • 267.
    activities with planneddates, durations, milestones, and resources. At a minimum, the project schedule includes a planned start date and planned finish date for each activity. If resource planning is done at an early stage, the project schedule remains preliminary until resource assignments have been confirmed and scheduled start and finish dates are established. This process usually occurs no later than the completion of the project management plan (Section 4.2.3.1). A target project schedule model may also be developed with a defined target start and target finish for each activity. The project schedule may be presented in summary form, sometimes referred to as the master schedule or milestone schedule, or presented in detail. Although a project schedule model can be presented in tabular form, it is more often presented graphically, using one or more of the following formats: Bar charts. Also known as Gantt charts, bar charts represent schedule information where activities are listed on the vertical axis, dates are shown on the horizontal axis, and activity durations are shown as horizontal bars placed according to start and finish dates. Bar charts are relatively easy to read and are commonly used. Depending on the audience, float can be depicted or not. For control and management communications, the broader, more comprehensive summary activity is used between milestones or across multiple interdependent work packages and is displayed in bar chart reports. An example is the summary schedule portion of Figure 6-21 that is presented in a WBS- structured format. Milestone charts. These charts are similar to bar charts, but only identify the scheduled start or completion of major deliverables and key external interfaces. An example is the milestone schedule portion of Figure 6-21. Project schedule network diagrams. These diagrams are commonly presented in the activity-on-node diagram format showing activities and relationships without a time scale, sometimes referred to as a pure logic diagram, as shown in Figure 6-11, or presented in a time-scaled schedule network diagram format that is sometimes called a logic bar chart, as shown for the detailed schedule in Figure 6-21. These diagrams, with activity date information, usually show both the project network logic and the project's critical path schedule activities. This example also shows how each work package is planned as a series of related activities. Another presentation of the project schedule network
  • 268.
    diagram is atime-scaled logic diagram. These diagrams include a time scale and bars that represent the duration of activities with the logical relationships. They are optimized to show the relationships between activities where any number of activities may appear on the same line of the diagram in sequence. Figure 6-21 shows schedule presentations for a sample project being executed, with the work in progress reported through as-of date or status date. For a simple project schedule model, Figure 6-21 reflects schedule presentations in the forms of (1) a milestone schedule as a milestone chart, (2) a summary schedule as a bar chart, and (3) a detailed schedule as a project schedule linked bar chart diagram. Figure 6-21 also visually shows the relationships among the different levels of detail of the project schedule.
  • 269.
    6.5.3.3 SCHEDULE DATA Theschedule data for the project schedule model is the collection of information for describing and controlling the schedule. The schedule data includes, at a minimum, the schedule milestones, schedule activities, activity attributes, and documentation of all identified assumptions and constraints. The amount of additional data varies by application area. Information frequently supplied as supporting detail includes but is not limited to: Resource requirements by time period, often in the form of a resource histogram;
  • 270.
    Alternative schedules, suchas best-case or worst-case, not resource- leveled or resource-leveled, or with or without imposed dates; and Applied schedule reserves. Schedule data could also include such items as resource histograms, cash-flow projections, order and delivery schedules, or other relevant information. 6.5.3.4 PROJECT CALENDARS A project calendar identifies working days and shifts that are available for scheduled activities. It distinguishes time periods in days or parts of days that are available to complete scheduled activities from time periods that are not available for work. A schedule model may require more than one project calendar to allow for different work periods for some activities to calculate the project schedule. The project calendars may be updated. 6.5.3.5 CHANGE REQUESTS Described in Section 4.3.3.4. Modifications to the project scope or project schedule may result in change requests to the scope baseline, and/or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). Preventive actions may include recommended changes to eliminate or reduce the probability of negative schedule variances. 6.5.3.6 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan may be updated to reflect a change in the way the schedule was developed and will be managed. Cost baseline. Described in Section 7.3.3.1. Changes to the cost baseline are incorporated in response to approved changes in scope, resources, or cost estimates. In some cases, cost variances can be so severe that a revised cost baseline is needed to provide a realistic basis for performance measurement.
  • 271.
    6.5.3.7 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity attributes are updated to include any revised resource requirements and any other revisions generated by the Develop Schedule process. Assumption log. Described in Section 4.1.3.2. The assumption log may be updated with changes to assumptions in duration, resource utilization, sequencing, or other information that is revealed as a result of developing the schedule model. Duration estimates. Described in Section 6.4.3.1. The number and availability of resources, along with the activity dependencies can result in a change to the duration estimates. If the resource-leveling analysis changes the resource requirements, then the duration estimates will likely need to be updated as well. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were efficient and effective in developing the schedule model. Resource requirements. Described in Section 9.2.3.1. Resource leveling can have a significant effect on preliminary estimates for the types and quantities of resources required. If the resource-leveling analysis changes the resource requirements, then the resource requirements are updated. Risk register. Described in Section 11.2.3.1. The risk register may need to be updated to reflect opportunities or threats perceived through scheduling assumptions. 6.6 CONTROL SCHEDULE Control Schedule is the process of monitoring the status of the project to update the project schedule and managing changes to the schedule baseline. The key benefit of this process is that the schedule baseline is maintained throughout the project. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 6-22. Figure 6- 23 depicts the data flow diagram of the process.
  • 273.
    Updating the schedulemodel requires knowing the actual performance to date. Any change to the schedule baseline can only be approved through the Perform Integrated Change Control process (Section 4.6). Control Schedule, as a component of the Perform Integrated Change Control process, is concerned with: Determining the current status of the project schedule, Influencing the factors that create schedule changes, Reconsidering necessary schedule reserves, Determining if the project schedule has changed, and Managing the actual changes as they occur. When an agile approach is used, Control Schedule is concerned with:
  • 274.
    Determining the currentstatus of the project schedule by comparing the total amount of work delivered and accepted against the estimates of work completed for the elapsed time cycle; Conducting retrospectives (scheduled reviews to record lessons learned) for correcting processes and improving, if required; Reprioritizing the remaining work plan (backlog); Determining the rate at which the deliverables are produced, validated, and accepted (velocity) in the given time per iteration (agreed-upon work cycle duration, typically 2 weeks or 1 month); Determining that the project schedule has changed; and Managing the actual changes as they occur. When work is being contracted, regular and milestone status updates from contractors and suppliers are a means of ensuring the work is progressing as agreed upon to ensure the schedule is under control. Scheduled status reviews and walkthroughs should be done to ensure the contractor reports are accurate and complete. 6.6.1 CONTROL SCHEDULE: INPUTS 6.6.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management describes the frequency that the schedule will be updated, how reserve will be used, and how the schedule will be controlled. Schedule baseline. Described in Section 6.5.3.1. The schedule baseline is compared with actual results to determine if a change, corrective action, or preventive action is necessary. Scope baseline. Described in Section 5.4.3.1. The project WBS, deliverables, constraints, and assumptions documented in the scope baseline are considered explicitly when monitoring and controlling the schedule baseline. Performance measurement baseline. Described in Section 4.2.3.1.
  • 275.
    When using earnedvalue analysis the performance measurement baseline is compared to actual results to determine if a change, corrective action, or preventive action is necessary. 6.6.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve schedule control. Project calendars. Described in Section 6.5.3.4. A schedule model may require more than one project calendar to allow for different work periods for some activities to calculate the schedule forecasts. Project schedule. Described in Section 6.5.3.2. Project schedule refers to the most recent version with notations to indicate updates, completed activities, and started activities as of the indicated date. Resource calendars. Described in Section 9.2.1.2. Resource calendars show the availability of team and physical resources. Schedule data. Described in Section 6.5.3.3. Schedule data will be reviewed and updated in the Control Schedule process. 6.6.1.3 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on project status such as which activities have started, their progress (e.g., actual duration, remaining duration, and physical percent complete), and which activities have finished. 6.6.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Control Schedule process include but are not limited to: Existing formal and informal schedule control-related policies, procedures, and guidelines; Schedule control tools; and Monitoring and reporting methods to be used.
  • 276.
    6.6.2 CONTROL SCHEDULE:TOOLS AND TECHNIQUES 6.6.2.1 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Earned value analysis. Described in Section 7.4.2.2. Schedule performance measurements such as schedule variance (SV) and schedule performance index (SPI) are used to assess the magnitude of variation to the original schedule baseline. Iteration burndown chart. This chart tracks the work that remains to be completed in the iteration backlog. It is used to analyze the variance with respect to an ideal burndown based on the work committed from iteration planning (see Section 6.4.2.8). A forecast trend line can be used to predict the likely variance at iteration completion and take appropriate actions during the course of the iteration. A diagonal line representing the ideal burndown and daily actual remaining work is then plotted. A trend line is then calculated to forecast completion based on remaining work. Figure 6-24 is an example of an iteration burndown chart. Performance reviews. Performance reviews measure, compare, and
  • 277.
    analyze schedule performanceagainst the schedule baseline such as actual start and finish dates, percent complete, and remaining duration for work in progress. Trend analysis. Described in Section 4.5.2.2. Trend analysis examines project performance over time to determine whether performance is improving or deteriorating. Graphical analysis techniques are valuable for understanding performance to date and for comparing to future performance goals in the form of completion dates. Variance analysis. Variance analysis looks at variances in planned versus actual start and finish dates, planned versus actual durations, and variances in float. Part of variance analysis is determining the cause and degree of variance relative to the schedule baseline (see Section 6.5.3.1), estimating the implications of those variances for future work to completion, and deciding whether corrective or preventive action is required. For example, a major delay on any activity not on the critical path may have little effect on the overall project schedule, while a much shorter delay on a critical or near- critical activity may require immediate action. What-if scenario analysis. Described in Section 6.5.2.4. What-if scenario analysis is used to assess the various scenarios guided by the output from the Project Risk Management processes to bring the schedule model into alignment with the project management plan and approved baseline. 6.6.2.2 CRITICAL PATH METHOD Described in Section 6.5.2.2. Comparing the progress along the critical path can help determine schedule status. The variance on the critical path will have a direct impact on the project end date. Evaluating the progress of activities on near critical paths can identify schedule risk. 6.6.2.3 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems include scheduling software that provides the ability to track planned dates versus actual dates, to report variances to and progress made against the schedule baseline, and to forecast the effects of changes to the project schedule model.
  • 278.
    6.6.2.4 RESOURCE OPTIMIZATION Describedin Section 6.5.2.3. Resource optimization techniques involve the scheduling of activities and the resources required by those activities while taking into consideration both the resource availability and the project time. 6.6.2.5 LEADS AND LAGS Adjusting leads and lags is applied during network analysis to find ways to bring project activities that are behind into alignment with the plan. For example, on a project to construct a new office building, the landscaping can be adjusted to start before the exterior work of the building is completed by increasing the lead time in the relationship, or a technical writing team can adjust the start of editing the draft of a large document immediately after the document is written by eliminating or decreasing lag time. 6.6.2.6 SCHEDULE COMPRESSION Schedule compression techniques (see Section 6.5.2.6) are used to find ways to bring project activities that are behind into alignment with the plan by fast tracking or crashing the schedule for the remaining work. 6.6.3 CONTROL SCHEDULE: OUTPUTS 6.6.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how the project work is performing compared to the schedule baseline. Variances in the start and finish dates and the durations can be calculated at the work package level and control account level. For projects using earned value analysis, the (SV) and (SPI) are documented for inclusion in work performance reports (see Section 4.5.3.1). 6.6.3.2 SCHEDULE FORECASTS Schedule updates are forecasts of estimates or predictions of conditions and events in the project's future based on information and knowledge available at the time of the forecast. Forecasts are updated and reissued based on work performance information provided as the project is executed. The information is based on the project's past performance and expected future performance based
  • 279.
    on corrective orpreventive actions. This can include earned value performance indicators, as well as schedule reserve information that could impact the project in the future. 6.6.3.3 CHANGE REQUESTS Described in Section 4.3.3.4. Schedule variance analysis, as well as reviews of progress reports, results of performance measures, and modifications to the project scope or project schedule, may result in change requests to the schedule baseline, scope baseline, and/or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). Preventive actions may include recommended changes to eliminate or reduce the probability of negative schedule variances. 6.6.3.4 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan may be updated to reflect a change in the way the schedule is managed. Schedule baseline. Described in Section 6.5.3.1. Changes to the schedule baseline are incorporated in response to approved change requests related to change in project scope, resources, or activity duration estimates. The schedule baseline may be updated to reflect changes caused by schedule compression techniques or performance issues. Cost baseline. Described in Section 7.3.3.1. Changes to the cost baseline are incorporated in response to approved changes in scope, resources, or cost estimates. Performance measurement baseline. Described in Section 4.2.3.1. Changes to the performance measurement baseline are incorporated in response to approved changes in scope, schedule performance, or cost estimates. In some cases, the performance variances can be so severe that a change request is put forth to revise the performance measurement baseline to provide a realistic basis for performance
  • 280.
    measurement. 6.6.3.5 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. Schedule performance may indicate the need to revise assumptions on activity sequencing, durations, and productivity. Basis of estimates. Described in Section 6.4.3.2. Schedule performance may indicate the need to revise the way duration estimates were developed. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were effective in maintaining the schedule, causes of variances, and corrective actions that were used to respond to schedule variances. Project schedule. An updated project schedule (see Section 6.5.3.2) will be generated from the schedule model populated with updated schedule data to reflect the schedule changes and manage the project. Resource calendars. Described in Section 9.2.1.2. Resource calendars are updated to reflect changes to the utilization of resource calendars that were the result of optimizing resources, schedule compression, and corrective or preventive actions. Risk register. Described in Section 11.2.3.1. The risk register and risk response plans within it, may be updated based on the risks that may arise due to schedule compression techniques. Schedule data. Described in Section 6.5.3.3. New project schedule network diagrams may be developed to display approved remaining durations and approved modifications to the schedule. In some cases, project schedule delays can be so severe that a new target schedule with forecasted start and finish dates is needed to provide realistic data for directing the work, measuring performance, and measuring progress.
  • 281.
    7 PROJECT COST MANAGEMENT ProjectCost Management includes the processes involved in planning, estimating, budgeting, financing, funding, managing, and controlling costs so that the project can be completed within the approved budget. The Project Cost Management processes are: 7.1 Plan Cost Management—The process of defining how the project costs will be estimated, budgeted, managed, monitored, and controlled. 7.2 Estimate Costs—The process of developing an approximation of the monetary resources needed to complete project work. 7.3 Determine Budget—The process of aggregating the estimated costs of individual activities or work packages to establish an authorized cost baseline. 7.4 Control Costs—The process of monitoring the status of the project to update the project costs and manage changes to the cost baseline. Figure 7-1 provides an overview of the Project Cost Management processes. The Project Cost Management processes are presented as discrete processes with defined interfaces, while in practice they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide. These processes interact with each other and with processes in other Knowledge Areas. On some projects, especially those of smaller scope, cost estimating and cost budgeting are tightly linked and can be viewed as a single process that can be performed by a single person over a relatively short period of time. They are presented here as distinct processes because the tools and techniques for each are different. The ability to influence cost is greatest at the early stages of the project, making early scope definition critical (see Section 5.3).
  • 282.
    KEY CONCEPTS FORPROJECT COST MANAGEMENT Project Cost Management is primarily concerned with the cost of the resources needed to complete project activities. Project Cost Management should consider the effect of project decisions on the subsequent recurring cost of using, maintaining, and supporting the product, service, or result of the project. For example, limiting the number of design reviews can reduce the cost of the project but could increase the resulting product's operating costs. Another aspect of cost management is recognizing that different stakeholders measure project costs in different ways and at different times. For example, the cost of an acquired item may be measured when the acquisition decision is made or committed, the order is placed, the item is delivered, or the actual cost is incurred or recorded for project accounting purposes. In many organizations,
  • 283.
    predicting and analyzingthe prospective financial performance of the project's product is performed outside of the project. In others, such as a capital facilities project, Project Cost Management can include this work. When such predictions and analyses are included, Project Cost Management may address additional processes and numerous general financial management techniques such as return on investment, discounted cash flow, and investment payback analysis. TRENDS AND EMERGING PRACTICES IN PROJECT COST MANAGEMENT Within the practice of Project Cost Management, trends include the expansion of earned value management (EVM) to include the concept of earned schedule (ES). ES is an extension to the theory and practice of EVM. Earned schedule theory replaces the schedule variance measures used in traditional EVM (earned value − planned value) with ES and actual time (AT). Using the alternate equation for calculating schedule variance ES − AT, if the amount of earned schedule is greater than 0, then the project is considered ahead of schedule. In other words, the project earned more than planned at a given point in time. The schedule performance index (SPI) using earned schedule metrics is ES/AT. This indicates the efficiency with which work is being accomplished. Earned schedule theory also provides formulas for forecasting the project completion date, using earned schedule, actual time, and estimated duration. TAILORING CONSIDERATIONS Because each project is unique, the project manager may need to tailor the way Project Cost Management processes are applied. Considerations for tailoring include but are not limited to: Knowledge management. Does the organization have a formal knowledge management and financial database repository that a project manager is required to use and that is readily accessible? Estimating and budgeting. Does the organization have existing formal or informal cost estimating and budgeting-related policies, procedures, and guidelines? Earned value management. Does the organization use earned value management in managing projects? Use of agile approach. Does the organization use agile methodologies
  • 284.
    in managing projects?How does this impact cost estimating? Governance. Does the organization have formal or informal audit and governance policies, procedures, and guidelines? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS Projects with high degrees of uncertainty or those where the scope is not yet fully defined may not benefit from detailed cost calculations due to frequent changes. Instead, lightweight estimation methods can be used to generate a fast, high-level forecast of project labor costs, which can then be easily adjusted as changes arise. Detailed estimates are reserved for short-term planning horizons in a just-in-time fashion. In cases where high-variability projects are also subject to strict budgets, the scope and schedule are more often adjusted to stay within cost constraints. 7.1 PLAN COST MANAGEMENT Plan Cost Management is the process of defining how the project costs will be estimated, budgeted, managed, monitored, and controlled. The key benefit of this process is that it provides guidance and direction on how the project costs will be managed throughout the project. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 7-2. Figure 7-3 depicts the data flow diagram of the process.
  • 285.
    The cost managementplanning effort occurs early in project planning and sets the framework for each of the cost management processes so that performance of the processes will be efficient and coordinated. The cost management processes and their associated tools and techniques are documented in the cost management plan. The cost management plan is a component of the project management plan. 7.1.1 PLAN COST MANAGEMENT: INPUTS 7.1.1.1 PROJECT CHARTER Described in Section 4.2.3.1. The project charter provides the preapproved financial resources from which the detailed project costs are developed. The project charter also defines the project approval requirements that will influence the management of the project costs. 7.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Schedule management plan. Described in Section 6.1.3.1. The schedule management plan establishes the criteria and the activities for
  • 286.
    developing, monitoring, andcontrolling the schedule. The schedule management plan provides processes and controls that will impact cost estimation and management. Risk management plan. Described in Section 11.1.3.1. The risk management plan provides the approach for identifying, analyzing, and monitoring risks. The risk management plan provides processes and controls that will impact cost estimation and management. 7.1.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Cost Management process include but are not limited to: Organizational culture and structure can influence cost management. Market conditions describe what products, services, and results are available in the regional and global markets. Currency exchange rates for project costs are sourced from more than one country. Published commercial information such as resource cost rate information is often available from commercial databases that track skills and human resource costs, and provide standard costs for material and equipment. Published seller price lists are another source of information. Project management information system provides alternative possibilities for managing cost. Productivity differences in different parts of the world can have a large influence on the cost of projects. 7.1.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Cost Management process include but are not limited to: Financial controls procedures (e.g., time reporting, required expenditure and disbursement reviews, accounting codes, and standard contract provisions); Historical information and lessons learned repository; Financial databases; and
  • 287.
    Existing formal andinformal cost estimating and budgeting-related policies, procedures, and guidelines. 7.1.2 PLAN COST MANAGEMENT: TOOLS AND TECHNIQUES 7.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Previous similar projects; Information in the industry, discipline, and application area; Cost estimating and budgeting; and Earned value management. 7.1.2.2 DATA ANALYSIS A data analysis technique that can be used for this process includes but is not limited to alternatives analysis. Alternatives analysis can include reviewing strategic funding options such as: self-funding, funding with equity, or funding with debt. It can also include consideration of ways to acquire project resources such as making, purchasing, renting, or leasing. 7.1.2.3 MEETINGS Project teams may hold planning meetings to develop the cost management plan. Attendees may include the project manager, the project sponsor, selected project team members, selected stakeholders, anyone with responsibility for project costs, and others as needed. 7.1.3 PLAN COST MANAGEMENT: OUTPUTS 7.1.3.1 COST MANAGEMENT PLAN The cost management plan is a component of the project management plan and describes how the project costs will be planned, structured, and controlled. The cost management processes and their associated tools and techniques are documented in the cost management plan.
  • 288.
    For example, thecost management plan can establish the following: Units of measure. Each unit used in measurements (such as staff hours, staff days, or weeks for time measures; meters, liters, tons, kilometers, or cubic yards for quantity measures; or lump sum in currency form) is defined for each of the resources. Level of precision. This is the degree to which cost estimates will be rounded up or down (e.g., US$995.59 to US$1,000), based on the scope of the activities and magnitude of the project. Level of accuracy. The acceptable range (e.g., ±10%) used in determining realistic cost estimates is specified, and may include an amount for contingencies. Organizational procedures links. The work breakdown structure (WBS) (Section 5.4) provides the framework for the cost management plan, allowing for consistency with the estimates, budgets, and control of costs. The WBS component used for the project cost accounting is called the control account. Each control account is assigned a unique code or account number(s) that links directly to the performing organization's accounting system. Control thresholds. Variance thresholds for monitoring cost performance may be specified to indicate an agreed-upon amount of variation to be allowed before some action needs to be taken. Thresholds are typically expressed as percentage deviations from the baseline plan. Rules of performance measurement. Earned value management (EVM) rules of performance measurement are set. For example, the cost management plan may: Define the points in the WBS at which measurement of control accounts will be performed; Establish the EVM techniques (e.g., weighted milestones, fixed- formula, percent complete, etc.) to be employed; and Specify tracking methodologies and the EVM computation equations for calculating projected estimate at completion (EAC) forecasts to provide a validity check on the bottom-up EAC. Reporting formats. The formats and frequency for the various cost reports are defined.
  • 289.
    Additional details. Additionaldetails about cost management activities include but are not limited to: Description of strategic funding choices, Procedure to account for fluctuations in currency exchange rates, and Procedure for project cost recording. For more specific information regarding earned value management, refer to the Practice Standard for Earned Value Management – Second Edition [17]. 7.2 ESTIMATE COSTS Estimate Costs is the process of developing an approximation of the cost of resources needed to complete project work. The key benefit of this process is that it determines the monetary resources required for the project. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of this process are depicted in Figure 7-4. Figure 7-5 depicts the data flow diagram of the process.
  • 290.
    A cost estimateis a quantitative assessment of the likely costs for resources required to complete the activity. It is a prediction that is based on the information known at a given point in time. Cost estimates include the identification and consideration of costing alternatives to initiate and complete the project. Cost trade-offs and risks should be considered, such as make versus buy, buy versus lease, and the sharing of resources in order to achieve optimal costs for the project. Cost estimates are generally expressed in units of some currency (i.e., dollars, euros, yen, etc.), although in some instances other units of measure, such as staff hours or staff days, are used to facilitate comparisons by eliminating the effects of currency fluctuations. Cost estimates should be reviewed and refined during the course of the project to reflect additional detail as it becomes available and assumptions are tested. The accuracy of a project estimate will increase as the project progresses through the project life cycle. For example, a project in the initiation phase may have a rough order of magnitude (ROM) estimate in the range of −25% to +75%. Later in the project, as more information is known, definitive estimates could narrow the range of accuracy to −5% to +10%. In some organizations, there are guidelines for when such refinements can be made and the degree of confidence or accuracy that is expected.
  • 291.
    Costs are estimatedfor all resources that will be charged to the project. This includes but is not limited to labor, materials, equipment, services, and facilities, as well as special categories such as an inflation allowance, cost of financing, or contingency costs. Cost estimates may be presented at the activity level or in summary form. 7.2.1 ESTIMATE COSTS: INPUTS 7.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Cost management plan. Described in Section 7.1.3.1. The cost management plan describes estimating methods that can be used and the level of precision and accuracy required for the cost estimate. Quality management plan. Described in Section 8.1.3.1. The quality management plan describes the activities and resources necessary for the project management team to achieve the quality objectives set for the project. Scope baseline. Described in Section 5.4.3.1. The scope baseline includes the project scope statement, WBS, and WBS dictionary: Project scope statement. The scope statement (Section 5.3.3.1) reflects funding constraints by period for the expenditure of project funds or other financial assumptions and constraints. Work breakdown structure. The WBS (Section 5.4.3.1) provides the relationships among all the project deliverables and their various components. WBS dictionary. The WBS dictionary (Section 5.4.3.) and related detailed statements of work provide an identification of the deliverables and a description of the work in each WBS component required to produce each deliverable. 7.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to:
  • 292.
    Lessons learned register.Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to developing cost estimates can be applied to later phases in the project to improve the accuracy and precision of the cost estimates. Project schedule. Described in Section 6.5.3.2. The schedule includes the type, quantity, and amount of time that team and physical resources will be active on the project. The duration estimates (Section 6.4.3.1) will affect cost estimates when resources are charged per unit of time and when there are seasonal fluctuations in costs. The schedule also provides useful information for projects that incorporate the cost of financing (including interest charges). Resource requirements. Described in Section 9.2.3.1. Resource requirements identify the types and quantities of resources required for each work package or activity. Risk register. Described in Section 11.2.3.1. The risk register contains details of individual project risks that have been identified and prioritized, and for which risk responses are required. The risk register provides detailed information that can be used to estimate costs. 7.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Estimate Costs process include but are not limited to: Market conditions. These conditions describe what products, services, and results are available in the market, from whom, and under what terms and conditions. Regional and/or global supply and demand conditions greatly influence resource costs. Published commercial information. Resource cost rate information is often available from commercial databases that track skills and human resource costs, and provide standard costs for material and equipment. Published seller price lists are another source of information. Exchange rates and inflation. For large-scale projects that extend multiple years with multiple currencies, the fluctuations of currencies and inflation need to be understood and built into the Estimate Cost process. 7.2.1.4 ORGANIZATIONAL PROCESS ASSETS
  • 293.
    The organizational processassets that can influence the Estimate Costs process include but are not limited to: Cost estimating policies, Cost estimating templates, Historical information and lessons learned repository. 7.2.2 ESTIMATE COSTS: TOOLS AND TECHNIQUES 7.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Previous similar projects; Information in the industry, discipline, and application area; and Cost estimating methods. 7.2.2.2 ANALOGOUS ESTIMATING Described in Section 6.4.2.2. Analogous cost estimating uses values, or attributes, of a previous project that are similar to the current project. Values and attributes of the projects may include but are not limited to: scope, cost, budget, duration, and measures of scale (e.g., size, weight). Comparison of these project values, or attributes, becomes the basis for estimating the same parameter or measurement for the current project. 7.2.2.3 PARAMETRIC ESTIMATING Described in Section 6.4.2.3. Parametric estimating uses a statistical relationship between relevant historical data and other variables (e.g., square footage in construction) to calculate a cost estimate for project work. This technique can produce higher levels of accuracy depending on the sophistication and underlying data built into the model. Parametric cost estimates can be applied to a total project or to segments of a project, in conjunction with other estimating methods. 7.2.2.4 BOTTOM-UP ESTIMATING
  • 294.
    Described in Section6.4.2.5. Bottom-up estimating is a method of estimating a component of work. The cost of individual work packages or activities is estimated to the greatest level of specified detail. The detailed cost is then summarized or “rolled up” to higher levels for subsequent reporting and tracking purposes. The cost and accuracy of bottom-up cost estimating are typically influenced by the size or other attributes of the individual activity or work package. 7.2.2.5 THREE-POINT ESTIMATING Described in Section 6.4.2.4. The accuracy of single-point cost estimates may be improved by considering estimation uncertainty and risk and using three estimates to define an approximate range for an activity's cost: Most likely (cM). The cost of the activity, based on realistic effort assessment for the required work and any predicted expenses. Optimistic (cO). The cost based on analysis of the best-case scenario for the activity. Pessimistic (cP). The cost based on analysis of the worst-case scenario for the activity. Depending on the assumed distribution of values within the range of the three estimates, the expected cost, cE, can be calculated using a formula. Two commonly used formulas are triangular and beta distributions. The formulas are: Triangular distribution. cE = (cO + cM + cP) / 3 Beta distribution. cE = (cO + 4cM + cP) / 6 Cost estimates based on three points with an assumed distribution provide an expected cost and clarify the range of uncertainty around the expected cost. 7.2.2.6 DATA ANALYSIS Data analysis techniques that can be used in the Estimate Costs process include but are not limited to: Alternatives analysis. Alternatives analysis is a technique used to evaluate identified options in order to select which options or approaches to use to execute and perform the work of the project. An example would be evaluating the cost, schedule, resource, and quality impacts of buying versus making a deliverable.
  • 295.
    Reserve analysis. Costestimates may include contingency reserves (sometimes called contingency allowances) to account for cost uncertainty. Contingency reserves are the budget within the cost baseline that is allocated for identified risks. Contingency reserves are often viewed as the part of the budget intended to address the known- unknowns that can affect a project. For example, rework for some project deliverables could be anticipated, while the amount of this rework is unknown. Contingency reserves may be estimated to account for this unknown amount of rework. Contingency reserves can be provided at any level from the specific activity to the entire project. The contingency reserve may be a percentage of the estimated cost, a fixed number, or may be developed by using quantitative analysis methods. As more precise information about the project becomes available, the contingency reserve may be used, reduced, or eliminated. Contingency should be clearly identified in cost documentation. Contingency reserves are part of the cost baseline and the overall funding requirements for the project. Cost of quality. Assumptions about costs of quality (Section 8.1.2.3) may be used to prepare the estimates. This includes evaluating the cost impact of additional investment in conformance versus the cost of nonconformance. It can also include looking at short-term cost reductions versus the implication of more frequent problems later on in the product life cycle. 7.2.2.7 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. The project management information system can include spreadsheets, simulation software, and statistical analysis tools to assist with cost estimating. Such tools simplify the use of some cost-estimating techniques and thereby facilitate rapid consideration of cost estimate alternatives. 7.2.2.8 DECISION MAKING The decision-making techniques that can be used in the Estimate Costs process include but are not limited to voting. Described in Section 5.2.2.4, voting is an assessment process having multiple alternatives with an expected
  • 296.
    outcome in theform of future actions. These techniques are useful for engaging team members to improve estimate accuracy and commitment to the emerging estimates. 7.2.3 ESTIMATE COSTS: OUTPUTS 7.2.3.1 COST ESTIMATES Cost estimates include quantitative assessments of the probable costs required to complete project work, as well as contingency amounts to account for identified risks, and management reserve to cover unplanned work. Cost estimates can be presented in summary form or in detail. Costs are estimated for all resources that are applied to the cost estimate. This includes but is not limited to direct labor, materials, equipment, services, facilities, information technology, and special categories such as cost of financing (including interest charges), an inflation allowance, exchange rates, or a cost contingency reserve. Indirect costs, if they are included in the project estimate, can be included at the activity level or at higher levels. 7.2.3.2 BASIS OF ESTIMATES The amount and type of additional details supporting the cost estimate vary by application area. Regardless of the level of detail, the supporting documentation should provide a clear and complete understanding of how the cost estimate was derived. Supporting detail for cost estimates may include: Documentation of the basis of the estimate (i.e., how it was developed), Documentation of all assumptions made, Documentation of any known constraints, Documentation of identified risks included when estimating costs, Indication of the range of possible estimates (e.g., US$10,000 (±10%) to indicate that the item is expected to cost between a range of values), and Indication of the confidence level of the final estimate.
  • 297.
    7.2.3.3 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. During the Cost Estimates process, new assumptions may be made, new constraints may be identified, and existing assumptions or constraints may be revisited and changed. The assumption log should be updated with this new information. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were efficient and effective in developing cost estimates. Risk register. Described in Section 11.2.3.1. The risk register may be updated when appropriate risk responses are chosen and agreed upon during the Estimate Cost process. 7.3 DETERMINE BUDGET Determine Budget is the process of aggregating the estimated costs of individual activities or work packages to establish an authorized cost baseline. The key benefit of this process is that it determines the cost baseline against which project performance can be monitored and controlled. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 7-6. Figure 7-7 depicts the data flow diagram of the process. A project budget includes all the funds authorized to execute the project. The cost baseline is the approved version of the time-phased project budget that includes contingency reserves, but excludes management reserves.
  • 299.
    7.3.1 DETERMINE BUDGET:INPUTS 7.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Cost management plan. Described in Section 7.1.3.1. The cost management plan describes how the project costs will be structured into the project budget. Resource management plan. Described in Section 9.1.3.1. The resource management plan provides information on rates (personnel
  • 300.
    and other resources),estimation of travel costs, and other foreseen costs that are necessary to estimate the overall project budget. Scope baseline. Described in Section 5.4.3.1. The scope baseline includes the project scope statement, WBS, and WBS dictionary details for cost estimation and management. 7.3.1.2 PROJECT DOCUMENTS Examples of project documents that can be considered as inputs for this process include but are not limited to: Basis of estimates. Described in Section 6.4.3.2. Supporting detail for cost estimates contained in the basis for estimates should specify any basic assumptions dealing with the inclusion or exclusion of indirect or other costs in the project budget. Cost estimates. Described in Section 7.2.3.1. Cost estimates for each activity within a work package are aggregated to obtain a cost estimate for each work package. Project schedule. Described in Section 6.5.3.2. The project schedule includes planned start and finish dates for the project's activities, milestones, work packages, and control accounts. This information can be used to aggregate costs to the calendar periods in which the costs are planned to be incurred. Risk register. Described in Section 11.2.3.1. The risk register should be reviewed to consider how to aggregate the risk response costs. Updates to the risk register are included with project documents updates described in Section 11.5.3.3. 7.3.1.3 BUSINESS DOCUMENTS Described in Section 1.2.6. The business documents that can be considered as inputs for this process include but are not limited to: Business case. The business case identifies the critical success factors for the project, including financial success factors. Benefits management plan. The benefits management plan includes the target benefits, such as net present value calculations, timeframe for realizing benefits, and the metrics associated with the benefits.
  • 301.
    7.3.1.4 AGREEMENTS Described inSection 12.2.3.2. Applicable agreement information and costs relating to products, services, or results that have been or will be purchased are included when determining the budget. 7.3.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Estimate Costs process include but are not limited to exchange rates. For large-scale projects that extend multiple years with multiple currencies, the fluctuations of currencies need to be understood and built into the Determine Budget process. 7.3.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Determine Budget process include but are not limited to: Existing formal and informal cost budgeting-related policies, procedures, and guidelines; Historical information and lessons learned repository. Cost budgeting tools; and Reporting methods. 7.3.2 DETERMINE BUDGET: TOOLS AND TECHNIQUES 7.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Previous similar projects; Information in the industry, discipline, and application area; Financial principles; and Funding requirement and sources. 7.3.2.2 COST AGGREGATION Cost estimates are aggregated by work packages in accordance with the WBS.
  • 302.
    The work packagecost estimates are then aggregated for the higher component levels of the WBS (such as control accounts) and, ultimately, for the entire project. 7.3.2.3 DATA ANALYSIS A data analysis technique that can be used in the Determine Budget process includes but is not limited to reserve analysis, which can establish the management reserves for the project. Management reserves are an amount of the project budget withheld for management control purposes and are reserved for unforeseen work that is within scope of the project. Management reserves are intended to address the unknown unknowns that can affect a project. The management reserve is not included in the cost baseline but is part of the overall project budget and funding requirements. When an amount of management reserves is used to fund unforeseen work, the amount of management reserve used is added to the cost baseline, thus requiring an approved change to the cost baseline. 7.3.2.4 HISTORICAL INFORMATION REVIEW Reviewing historical information can assist in developing parametric estimates or analogous estimates. Historical information may include project characteristics (parameters) to develop mathematical models to predict total project costs. Such models may be simple (e.g., residential home construction is based on a certain cost per square foot of space) or complex (e.g., one model of software development costing uses multiple separate adjustment factors, each of which has numerous points within it). Both the cost and accuracy of analogous and parametric models can vary widely. They are most likely to be reliable when: Historical information used to develop the model is accurate, Parameters used in the model are readily quantifiable, and Models are scalable, such that they work for large projects, small projects, and phases of a project. 7.3.2.5 FUNDING LIMIT RECONCILIATION The expenditure of funds should be reconciled with any funding limits on the commitment of funds for the project. A variance between the funding limits and the planned expenditures will sometimes necessitate the rescheduling of work to
  • 303.
    level out therate of expenditures. This is accomplished by placing imposed date constraints for work into the project schedule. 7.3.2.6 FINANCING Financing entails acquiring funding for projects. It is common for long-term infrastructure, industrial, and public services projects to seek external sources of funds. If a project is funded externally, the funding entity may have certain requirements that are required to be met. 7.3.3 DETERMINE BUDGET: OUTPUTS 7.3.3.1 COST BASELINE The cost baseline is the approved version of the time-phased project budget, excluding any management reserves, which can only be changed through formal change control procedures. It is used as a basis for comparison to actual results. The cost baseline is developed as a summation of the approved budgets for the different schedule activities. Figure 7-8 illustrates the various components of the project budget and cost baseline. Cost estimates for the various project activities, along with any contingency reserves (see Section 7.2.2.6) for these activities, are aggregated into their associated work package costs. The work package cost estimates, along with any contingency reserves estimated for the work packages, are aggregated into control accounts. The summation of the control accounts make up the cost baseline. Since the cost estimates that make up the cost baseline are directly tied to the schedule activities, this enables a time-phased view of the cost baseline, which is typically displayed in the form of an S-curve, as is illustrated in Figure 7-9. For projects that use earned value management, the cost baseline is referred to as the performance measurement baseline. Management reserves (Section 7.2.2.3) are added to the cost baseline to produce the project budget. As changes warranting the use of management reserves arise, the change control process is used to obtain approval to move the applicable management reserve funds into the cost baseline.
  • 304.
    7.3.3.2 PROJECT FUNDINGREQUIREMENTS Total funding requirements and periodic funding requirements (e.g., quarterly, annually) are derived from the cost baseline. The cost baseline will include projected expenditures plus anticipated liabilities. Funding often occurs in
  • 305.
    incremental amounts, andmay not be evenly distributed, which appear as steps in Figure 7-9. The total funds required are those included in the cost baseline plus management reserves, if any. Funding requirements may include the source(s) of the funding. 7.3.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Cost estimates. Described in Section 7.2.3.1. Cost estimates are updated to record any additional information. Project schedule. Described in Section 6.5.3.2. Estimated costs for each activity may be recorded as part of the project schedule. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. 7.4 CONTROL COSTS Control Costs is the process of monitoring the status of the project to update the project costs and managing changes to the cost baseline. The key benefit of this process is that the cost baseline is maintained throughout the project. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 7-10. Figure 7-11 depicts the data flow diagram of the process.
  • 307.
    Updating the budgetrequires knowledge of the actual costs spent to date. Any increase to the authorized budget can only be approved through the Perform Integrated Change Control process (Section 4.6). Monitoring the expenditure of funds without regard to the value of work being accomplished for such expenditures has little value to the project, other than to track the outflow of funds. Much of the effort of cost control involves analyzing the relationship between the consumption of project funds and the work being accomplished for such expenditures. The key to effective cost control is the management of the approved cost baseline. Project cost control includes: Influencing the factors that create changes to the authorized cost baseline; Ensuring that all change requests are acted on in a timely manner; Managing the actual changes when and as they occur; Ensuring that cost expenditures do not exceed the authorized funding by period, by WBS component, by activity, and in total for the project; Monitoring cost performance to isolate and understand variances from the approved cost baseline; Monitoring work performance against funds expended; Preventing unapproved changes from being included in the reported cost or resource usage; Informing appropriate stakeholders of all approved changes and associated cost; and Bringing expected cost overruns within acceptable limits. 7.4.1 CONTROL COSTS: INPUTS 7.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Cost management plan. Described in Section 7.1.3.1. The cost management plan describes how the project costs will be managed and controlled.
  • 308.
    Cost baseline. Describedin Section 7.3.3.1. The cost baseline is compared with actual results to determine if a change, corrective action, or preventive action is necessary. Performance measurement baseline. Described in Section 4.2.3.1. When using earned value analysis, the performance measurement baseline is compared to actual results to determine if a change, corrective action, or preventive action is necessary. 7.4.1.2. PROJECT DOCUMENTS Examples of project documents that can be considered as inputs for this process include but are not limited to the lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve cost control. 7.4.1.3 PROJECT FUNDING REQUIREMENTS Described in Section 7.3.3.2. The project funding requirements include projected expenditures plus anticipated liabilities. 7.4.1.4 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on project status such as which costs have been authorized, incurred, invoiced, and paid. 7.4.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Control Costs process include but are not limited to: Existing formal and informal cost control-related policies, procedures, and guidelines; Cost control tools; and Monitoring and reporting methods to be used. 7.4.2 CONTROL COSTS: TOOLS AND TECHNIQUES 7.4.2.1 EXPERT JUDGMENT
  • 309.
    Described in Section4.1.2.1. Examples of expert judgment during the Control Costs process include but are not limited to: Variance analysis, Earned value analysis, Forecasting, and Financial analysis. 7.4.2.2 DATA ANALYSIS Data analysis techniques that can be used to control costs include but are not limited to: Earned value analysis (EVA). Earned value analysis compares the performance measurement baseline to the actual schedule and cost performance. EVM integrates the scope baseline with the cost baseline and schedule baseline to form the performance measurement baseline. EVM develops and monitors three key dimensions for each work package and control account: Planned value. Planned value (PV) is the authorized budget assigned to scheduled work. It is the authorized budget planned for the work to be accomplished for an activity or work breakdown structure (WBS) component, not including management reserve. This budget is allocated by phase over the life of the project, but at a given point in time, planned value defines the physical work that should have been accomplished. The total of the PV is sometimes referred to as the performance measurement baseline (PMB). The total planned value for the project is also known as budget at completion (BAC). Earned value. Earned value (EV) is a measure of work performed expressed in terms of the budget authorized for that work. It is the budget associated with the authorized work that has been completed. The EV being measured needs to be related to the PMB, and the EV measured cannot be greater than the authorized PV budget for a component. The EV is often used to calculate the percent complete of a project. Progress measurement criteria should be established for each WBS component to measure work in progress. Project managers monitor EV, both incrementally to determine current status and cumulatively to determine the long-term performance trends.
  • 310.
    Actual cost. Actualcost (AC) is the realized cost incurred for the work performed on an activity during a specific time period. It is the total cost incurred in accomplishing the work that the EV measured. The AC needs to correspond in definition to what was budgeted in the PV and measured in the EV (e.g., direct hours only, direct costs only, or all costs including indirect costs). The AC will have no upper limit; whatever is spent to achieve the EV will be measured. Variance analysis. Described in Section 4.5.2.2. Variance analysis, as used in EVM, is the explanation (cause, impact, and corrective actions) for cost (CV = EV – AC), schedule (SV = EV – PV), and variance at completion (VAC = BAC – EAC) variances. Cost and schedule variances are the most frequently analyzed measurements. For projects not using formal earned value analysis, similar variance analyses can be performed by comparing planned cost against actual cost to identify variances between the cost baseline and actual project performance. Further analysis can be performed to determine the cause and degree of variance relative to the schedule baseline and any corrective or preventive actions needed. Cost performance measurements are used to assess the magnitude of variation to the original cost baseline. An important aspect of project cost control includes determining the cause and degree of variance relative to the cost baseline (see Section 7.3.3.1) and deciding whether corrective or preventive action is required. The percentage range of acceptable variances will tend to decrease as more work is accomplished. Examples of variance analysis include but are not limited to: Schedule variance. Schedule variance (SV) is a measure of schedule performance expressed as the difference between the earned value and the planned value. It is the amount by which the project is ahead or behind the planned delivery date, at a given point in time. It is a measure of schedule performance on a project. It is equal to the earned value (EV) minus the planned value (PV). The EVA schedule variance is a useful metric in that it can indicate when a project is falling behind or is ahead of its baseline schedule. The EVA schedule variance will ultimately equal zero when the project is completed because all of the planned values will have been earned. Schedule variance is best used in conjunction with critical path method (CPM) scheduling and risk management. Equation: SV = EV – PV.
  • 311.
    Cost variance. Costvariance (CV) is the amount of budget deficit or surplus at a given point in time, expressed as the difference between earned value and the actual cost. It is a measure of cost performance on a project. It is equal to the earned value (EV) minus the actual cost (AC). The cost variance at the end of the project will be the difference between the budget at completion (BAC) and the actual amount spent. The CV is particularly critical because it indicates the relationship of physical performance to the costs spent. Negative CV is often difficult for the project to recover. Equation: CV = EV – AC. Schedule performance index. The schedule performance index (SPI) is a measure of schedule efficiency expressed as the ratio of earned value to planned value. It measures how efficiently the project team is accomplishing the work. It is sometimes used in conjunction with the cost performance index (CPI) to forecast the final project completion estimates. An SPI value less than 1.0 indicates less work was completed than was planned. An SPI greater than 1.0 indicates that more work was completed than was planned. Since the SPI measures all project work, the performance on the critical path also needs to be analyzed to determine whether the project will finish ahead of or behind its planned finish date. The SPI is equal to the ratio of the EV to the PV. Equation: SPI = EV/PV. Cost performance index. The cost performance index (CPI) is a measure of the cost efficiency of budgeted resources, expressed as a ratio of earned value to actual cost. It is considered the most critical EVA metric and measures the cost efficiency for the work completed. A CPI value of less than 1.0 indicates a cost overrun for work completed. A CPI value greater than 1.0 indicates a cost underrun of performance to date. The CPI is equal to the ratio of the EV to the AC. Equation: CPI = EV/AC. Trend analysis. Described in Section 4.5.2.2. Trend analysis examines project performance over time to determine if performance is improving or deteriorating. Graphical analysis techniques are valuable for understanding performance to date and for comparison to future performance goals in the form of BAC versus estimate at completion (EAC) and completion dates. Examples of the trend analysis techniques include but are not limited to: Charts. In earned value analysis, three parameters of planned value,
  • 312.
    earned value, andactual cost can be monitored and reported on both a period-by-period basis (typically weekly or monthly) and on a cumulative basis. Figure 7-12 uses S-curves to display EV data for a project that is performing over budget and behind the schedule. Forecasting. As the project progresses, the project team may develop a forecast for the estimate at completion (EAC) that may differ from the budget at completion (BAC) based on the project performance. If it becomes obvious that the BAC is no longer viable, the project manager should consider the forecasted EAC. Forecasting the EAC involves making projections of conditions and events in the project's future based on current performance information and other knowledge available at the time of the forecast. Forecasts are generated, updated, and reissued based on work performance data (Section 4.3.3.2) that is provided as the project is executed. The work performance information covers the project's past performance and any information that could impact the project in the future. EACs are typically based on the actual costs incurred for work completed, plus an estimate to complete (ETC) the remaining work. It is incumbent on the project team to predict what it may encounter to perform the ETC, based on its experience to date. Earned value analysis works well in conjunction with manual forecasts of the required EAC
  • 313.
    costs. The mostcommon EAC forecasting approach is a manual, bottom-up summation by the project manager and project team. The project manager's bottom-up EAC method builds upon the actual costs and experience incurred for the work completed, and requires a new estimate to complete the remaining project work. Equation: EAC = AC + Bottom-up ETC. The project manager's manual EAC is quickly compared with a range of calculated EACs representing various risk scenarios. When calculating EAC values, the cumulative CPI and SPI values are typically used. While EVM data quickly provide many statistical EACs, only three of the more common methods are described as follows: EAC forecast for ETC work performed at the budgeted rate. This EAC method accepts the actual project performance to date (whether favorable or unfavorable) as represented by the actual costs, and predicts that all future ETC work will be accomplished at the budgeted rate. When actual performance is unfavorable, the assumption that future performance will improve should be accepted only when supported by project risk analysis. Equation: EAC = AC + (BAC – EV). EAC forecast for ETC work performed at the present CPI. This method assumes that what the project has experienced to date can be expected to continue in the future. The ETC work is assumed to be performed at the same cumulative cost performance index (CPI) as that incurred by the project to date. Equation: EAC = BAC / CPI. EAC forecast for ETC work considering both SPI and CPI factors. In this forecast, the ETC work will be performed at an efficiency rate that considers both the cost and schedule performance indices. This method is most useful when the project schedule is a factor impacting the ETC effort. Variations of this method weight the CPI and SPI at different values (e.g., 80/20, 50/50, or some other ratio) according to the project manager's judgment. Equation: EAC = AC + [(BAC – EV) / (CPI × SPI)]. Reserve analysis. Described in Section 7.2.2.6. During cost control, reserve analysis is used to monitor the status of contingency and management reserves for the project to determine if these reserves are
  • 314.
    still needed orif additional reserves need to be requested. As work on the project progresses, these reserves may be used as planned to cover the cost of risk responses or other contingencies. Conversely, when opportunities are captured and resulting in cost savings, funds may be added to the contingency amount, or taken from the project as margin/profit. If the identified risks do not occur, the unused contingency reserves may be removed from the project budget to free up resources for other projects or operations. Additional risk analysis during the project may reveal a need to request that additional reserves be added to the project budget. 7.4.2.3 TO-COMPLETE PERFORMANCE INDEX The to-complete performance index (TCPI) is a measure of the cost performance that is required to be achieved with the remaining resources in order to meet a specified management goal, expressed as the ratio of the cost to finish the outstanding work to the remaining budget. TCPI is the calculated cost performance index that is achieved on the remaining work to meet a specified management goal, such as the BAC or the EAC. If it becomes obvious that the BAC is no longer viable, the project manager should consider the forecasted EAC. Once approved, the EAC may replace the BAC in the TCPI calculation. The equation for the TCPI based on the BAC: (BAC – EV) / (BAC – AC). The TCPI is conceptually displayed in Figure 7-13. The equation for the TCPI is shown in the lower left as the work remaining (defined as the BAC minus the EV) divided by the funds remaining (which can be either the BAC minus the AC, or the EAC minus the AC). If the cumulative CPI falls below the baseline (as shown in Figure 7-13), all future work of the project will need to be performed immediately in the range of the TCPI (BAC) (as reflected in the top line of Figure 7-13) to stay within the authorized BAC. Whether this level of performance is achievable is a judgment call based on a number of considerations, including risk, time remaining in the project, and technical performance. This level of performance is displayed as the TCPI (EAC) line. The equation for the TCPI is based on the EAC: (BAC – EV) / (EAC – AC). The EVM formulas are provided in Table 7-1.
  • 316.
    7.4.2.4 PROJECT MANAGEMENTINFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems are often used to monitor the three EVM dimensions (PV, EV, and AC), to display graphical trends, and to forecast a range of possible final project results. 7.4.3 CONTROL COSTS: OUTPUTS 7.4.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how the project work is performing compared to the cost baseline. Variances in the work performed and the cost of the work are evaluated at the work package level and control account level. For projects using earned value analysis, CV, CPI, EAC, VAC, and TCPI are documented for inclusion in work performance reports (Section 4.5.3.1). 7.4.3.2 COST FORECASTS Either a calculated EAC value or a bottom-up EAC value is documented and communicated to stakeholders.
  • 317.
    7.4.3.3 CHANGE REQUESTS Describedin Section 4.3.3.4. Analysis of project performance may result in a change request to the cost and schedule baselines or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 7.4.3.4 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Cost management plan. Described in Section 7.1.3.1. Changes to the cost management plan, such as changes to control thresholds or specified levels of accuracy required in managing the project's cost, are incorporated in response to feedback from relevant stakeholders. Cost baseline. Described in Section 7.3.3.1. Changes to the cost baseline are incorporated in response to approved changes in scope, resources, or cost estimates. In some cases, cost variances can be so severe that a revised cost baseline is needed to provide a realistic basis for performance measurement. Performance measurement baseline. Described in Section 4.2.3.1. Changes to the performance measurement baseline are incorporated in response to approved changes in scope, schedule performance, or cost estimates. In some cases, the performance variances can be so severe that a change request is put forth to revise the performance measurement baseline to provide a realistic basis for performance measurement. 7.4.3.5 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. Cost performance may indicate the need to revise assumptions on resource productivity and other factors influencing cost performance. Basis of estimates. Described in Section 6.4.3.2. Cost performance
  • 318.
    may indicate theneed to revisit the original basis of estimates. Cost estimates. Described in Section 7.2.3.1. Cost estimates may need to be updated to reflect the actual cost efficiency for the project. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were effective in maintaining the budget, variance analysis, earned value analysis, forecasting, and corrective actions that were used to respond to cost variances. Risk register. Described in Section 11.2.3.1. The risk register may be updated if the cost variances have crossed, or are likely to cross, the cost threshold.
  • 319.
    8 PROJECT QUALITY MANAGEMENT ProjectQuality Management includes the processes for incorporating the organization's quality policy regarding planning, managing, and controlling project and product quality requirements in order to meet stakeholders’ objectives. Project Quality Management also supports continuous process improvement activities as undertaken on behalf of the performing organization. The Project Quality Management processes are: 8.1 Plan Quality Management—The process of identifying quality requirements and/or standards for the project and its deliverables, and documenting how the project will demonstrate compliance with quality requirements and/or standards. 8.2 Manage Quality—The process of translating the quality management plan into executable quality activities that incorporate the organization's quality policies into the project. 8.3 Control Quality—The process of monitoring and recording the results of executing the quality management activities to assess performance and ensure the project outputs are complete, correct, and meet customer expectations. Figure 8-1 provides an overview of the Project Quality Management processes. The Project Quality Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide. In addition, these quality processes may differ within industries and companies.
  • 320.
    Figure 8-2 providesan overview of the major inputs and outputs of the Project Quality Management processes and the interrelations of these processes in the Project Quality Management Knowledge Area. The Plan Quality Management process is concerned with the quality that the work needs to have. Manage Quality is concerned with managing the quality processes throughout the project. During the Manage Quality process, quality requirements identified during the Plan Quality Management process are turned into test and evaluation instruments, which are then applied during the Control Quality process to verify these quality requirements are met by the project. Control Quality is concerned with comparing the work results with the quality requirements to ensure the result is acceptable. There are two outputs specific to the Project Quality Management Knowledge Area that are used by other Knowledge Areas: verified deliverables and quality reports.
  • 321.
    KEY CONCEPTS FORPROJECT QUALITY MANAGEMENT Project Quality Management addresses the management of the project and the deliverables of the project. It applies to all projects, regardless of the nature of their deliverables. Quality measures and techniques are specific to the type of deliverables being produced by the project. For example, the project quality management of software deliverables may use different approaches and measures from those used when building a nuclear power plant. In either case, failure to meet the quality requirements can have serious negative consequences for any or all of the project's stakeholders. For example: Meeting customer requirements by overworking the project team may result in decreased profits and increased levels of overall project risks, employee attrition, errors, or rework. Meeting project schedule objectives by rushing planned quality inspections may result in undetected errors, decreased profits, and increased post-implementation risks. Quality and grade are not the same concepts. Quality as a delivered
  • 322.
    performance or resultis “the degree to which a set of inherent characteristics fulfill requirements” (ISO 9000 [18].). Grade as a design intent is a category assigned to deliverables having the same functional use but different technical characteristics. The project manager and the project management team are responsible for managing the trade-offs associated with delivering the required levels of both quality and grade. While a quality level that fails to meet quality requirements is always a problem, a low-grade product may not be a problem. For example: It may not be a problem if a suitable low-grade product (one with a limited number of features) is of high quality (no obvious defects). In this example, the product would be appropriate for its general purpose of use. It may be a problem if a high-grade product (one with numerous features) is of low quality (many defects). In essence, a high-grade feature set would prove ineffective and/or inefficient due to low quality. Prevention is preferred over inspection. It is better to design quality into deliverables, rather than to find quality issues during inspection. The cost of preventing mistakes is generally much less than the cost of correcting mistakes when they are found by inspection or during usage. Depending on the project and the industry area, the project team may need a working knowledge of statistical control processes to evaluate data contained in the Control Quality outputs. The team should know the differences between the following pairs of terms: Prevention (keeping errors out of the process) and inspection (keeping errors out of the hands of the customer); Attribute sampling (the result either conforms or does not conform) and variable sampling (the result is rated on a continuous scale that measures the degree of conformity); and Tolerances (specified range of acceptable results) and control limits (that identify the boundaries of common variation in a statistically stable process or process performance). The cost of quality (COQ) includes all costs incurred over the life of the product by investment in preventing nonconformance to requirements, appraising the product or service for conformance to requirements, and failing to meet requirements (rework). Failure costs are often categorized into internal
  • 323.
    (found by theproject team) and external (found by the customer). Failure costs are also called the cost of poor quality. Section 8.1.2.3 provides some examples to consider in each area. Organizations choose to invest in defect prevention because of the benefits over the life of the product. Because projects are temporary, decisions about the COQ over a product's life cycle are often the concern of program management, portfolio management, the PMO, or operations. There are five levels of increasingly effective quality management as follows: Usually, the most expensive approach is to let the customer find the defects. This approach can lead to warranty issues, recalls, loss of reputation, and rework costs. Detect and correct the defects before the deliverables are sent to the customer as part of the quality control process. The control quality process has related costs, which are mainly the appraisal costs and internal failure costs. Use quality assurance to examine and correct the process itself and not just special defects. Incorporate quality into the planning and designing of the project and product. Create a culture throughout the organization that is aware and committed to quality in processes and products. TRENDS AND EMERGING PRACTICES IN PROJECT QUALITY MANAGEMENT Modern quality management approaches seek to minimize variation and to deliver results that meet defined stakeholder requirements. Trends in Project Quality Management include but are not limited to: Customer satisfaction. Understand, evaluate, define, and manage requirements so that customer expectations are met. This requires a combination of conformance to requirements (to ensure the project produces what it was created to produce) and fitness for use (the product or service needs to satisfy the real needs). In agile environments, stakeholder engagement with the team ensures customer satisfaction is maintained throughout the project. Continual improvement. The plan-do-check-act (PDCA) cycle is the
  • 324.
    basis for qualityimprovement as defined by Shewhart and modified by Deming. In addition, quality improvement initiatives such as total quality management (TQM), Six Sigma, and Lean Six Sigma may improve both the quality of project management, as well as the quality of the end product, service, or result. Management responsibility. Success requires the participation of all members of the project team. Management retains, within its responsibility for quality, a related responsibility to provide suitable resources at adequate capacities. Mutually beneficial partnership with suppliers. An organization and its suppliers are interdependent. Relationships based on partnership and cooperation with the supplier are more beneficial to the organization and to the suppliers than traditional supplier management. The organization should prefer long-term relationships over short-term gains. A mutually beneficial relationship enhances the ability for both the organization and the suppliers to create value for each other, enhances the joint responses to customer needs and expectations, and optimizes costs and resources. TAILORING CONSIDERATIONS Each project is unique; therefore, the project manager will need to tailor the way Project Quality Management processes are applied. Considerations for tailoring include but are not limited to: Policy compliance and auditing. What quality policies and procedures exist in the organization? What quality tools, techniques, and templates are used in the organization? Standards and regulatory compliance. Are there any specific quality standards in the industry that need to be applied? Are there any specific governmental, legal, or regulatory constraints that need to be taken into consideration? Continuous improvement. How will quality improvement be managed in the project? Is it managed at the organizational level or at the level of each project? Stakeholder engagement. Is there a collaborative environment for stakeholders and suppliers?
  • 325.
    CONSIDERATIONS FOR AGILE/ADAPTIVEENVIRONMENTS In order to navigate changes, agile methods call for frequent quality and review steps built in throughout the project rather than toward the end of the project. Recurring retrospectives regularly check on the effectiveness of the quality processes. They look for the root cause of issues then suggest trials of new approaches to improve quality. Subsequent retrospectives evaluate any trial processes to determine if they are working and should be continued or new adjusting or should be dropped from use. In order to facilitate frequent, incremental delivery, agile methods focus on small batches of work, incorporating as many elements of project deliverables as possible. Small batch systems aim to uncover inconsistencies and quality issues earlier in the project life cycle when the overall costs of change are lower. 8.1 PLAN QUALITY MANAGEMENT Plan Quality Management is the process of identifying quality requirements and/or standards for the project and its deliverables, and documenting how the project will demonstrate compliance with quality requirements and/or standards. The key benefit of this process is that it provides guidance and direction on how quality will be managed and verified throughout the project. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 8.3. Figure 8.4 depicts the data flow diagram for the process.
  • 327.
    Quality planning shouldbe performed in parallel with the other planning processes. For example, changes proposed in the deliverables in order to meet identified quality standards may require cost or schedule adjustments and a detailed risk analysis of the impact to plans. The quality planning techniques discussed here are those used most frequently on projects. There are many others that may be useful on certain projects or in specific application areas. 8.1.1 PLAN QUALITY MANAGEMENT: INPUTS 8.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter provides the high-level project description and product characteristics. It also contains the project approval requirements, measurable project objectives, and related success criteria that will influence the quality management of the project. 8.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Requirements management plan. Described in Section 5.1.3.2. The requirements management plan provides the approach for identifying, analyzing, and managing the requirements that the quality management plan and quality metrics will reference. Risk management plan. Described in Section 11.1.3.1. The risk management plan provides the approach for identifying, analyzing, and monitoring risks. The information in the risk management plan and quality management plan work together to successfully deliver product and project success. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan provides the method for documenting the stakeholders’ needs and expectations that provide the foundation for quality management. Scope baseline. Described in Section 5.4.3.1. The WBS along with the deliverables documented in the project scope statement are considered
  • 328.
    while determining whichquality standards and objectives are suitable for the project, and which project deliverables and processes will be subjected to quality review. The scope statement includes the acceptance criteria for the deliverables. The definition of acceptance criteria may significantly increase or decrease quality costs and, therefore, project costs. Satisfying all acceptance criteria implies the needs of the stakeholders have been met. 8.1.1.3 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log has all the assumptions and constraints regarding quality requirements and standard compliance. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation captures the requirements that the project and product should attain to meet stakeholder expectations. The components of the requirements documentation include but are not limited to project and product quality requirements. Requirements are used by the project team to help plan how quality control will be implemented on the project. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix links product requirements to deliverables and helps to ensure each requirement in the requirements documentation is tested. The matrix provides an overview of the tests required to verify the requirements. Risk register. Described in Section 11.2.3.1. The risk register contains information on threats and opportunities that may impact quality requirements. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register helps to identify stakeholders who have a particular interest in or impact on quality, with the emphasis on the customer and project sponsor needs and expectations. 8.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Quality
  • 329.
    Management process includebut are not limited to: Governmental agency regulations; Rules, standards, and guidelines specific to the application area; Geographic distribution; Organizational structure; Marketplace conditions; Working or operating conditions of the project or its deliverables; and Cultural perceptions. 8.1.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Quality Management process include but are not limited to: Organizational quality management system including policies, procedures, and guidelines; Quality templates such as check sheets, traceability matrix, and others; and Historical databases and lessons learned repository. 8.1.2 PLAN QUALITY MANAGEMENT: TOOLS AND TECHNIQUES 8.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Quality assurance, Quality control, Quality measurements, Quality improvements, and Quality systems. 8.1.2.2 DATA GATHERING
  • 330.
    Data-gathering techniques thatcan be used for this process include but are not limited to: Benchmarking. Benchmarking involves comparing actual or planned project practices or the project's quality standards to those of comparable projects to identify best practices, generate ideas for improvement, and provide a basis for measuring performance. Benchmarked projects may exist within the performing organization or outside of it, or can be within the same application area or other application area. Benchmarking allows for analogies from projects in a different application area or different industries to be made. Brainstorming. Described in Section 4.1.2.2. Brainstorming can be used to gather data creatively from a group of team members or subject matter experts to develop the quality management plan that best fits the upcoming project. Interviews. Described in Section 5.2.2.2. Project and product quality needs and expectations, implicit and explicit, formal and informal, can be identified by interviewing experienced project participants, stakeholders, and subject matter experts. Interviews should be conducted in an environment of trust and confidentiality to encourage honest and unbiased contributions. 8.1.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Cost-benefit analysis. A cost-benefit analysis is a financial analysis tool used to estimate the strengths and weaknesses of alternatives in order to determine the best alternative in terms of benefits provided. A cost-benefit analysis will help the project manager determine if the planned quality activities are cost effective. The primary benefits of meeting quality requirements include less rework, higher productivity, lower costs, increased stakeholder satisfaction, and increased profitability. A cost-benefit analysis for each quality activity compares the cost of the quality step to the expected benefit. Cost of quality. The cost of quality (COQ) associated with a project consists of one or more of the following costs (Figure 8-5 lists examples for each cost group):
  • 331.
    Prevention costs. Costsrelated to the prevention of poor quality in the products, deliverables, or services of the specific project. Appraisal costs. Costs related to evaluating, measuring, auditing, and testing the products, deliverables, or services of the specific project. Failure costs (internal/external). Costs related to nonconformance of the products, deliverables, or services to the needs or expectations of the stakeholders. The optimal COQ is one that reflects the appropriate balance for investing in the cost of prevention and appraisal to avoid failure costs. Models show that there is an optimal quality cost for projects, where investing in additional prevention/appraisal costs is neither beneficial nor cost effective. 8.1.2.4 DECISION MAKING A decision-making technique that can be used for this process includes but is not limited to multicriteria decision analysis. Multicriteria decision analysis tools (e.g., prioritization matrix) can be used to identify the key issues and suitable alternatives to be prioritized as a set of decisions for implementation. Criteria are prioritized and weighted before being applied to all available alternatives to obtain a mathematical score for each alternative. The alternatives are then ranked by score. As used in this process, it can help prioritize quality metrics.
  • 332.
    8.1.2.5 DATA REPRESENTATION Datarepresentation techniques that can be used for this process include but are not limited to: Flowcharts. Flowcharts are also referred to as process maps because they display the sequence of steps and the branching possibilities that exist for a process that transforms one or more inputs into one or more outputs. Flowcharts show the activities, decision points, branching loops, parallel paths, and the overall order of processing by mapping the operational details of procedures that exist within a horizontal value chain. One version of a value chain, known as a SIPOC (suppliers, inputs, process, outputs, and customers) model, is shown in Figure 8-6. Flowcharts may prove useful in understanding and estimating the cost of quality for a process. Information is obtained by using the workflow branching logic and associated relative frequencies to estimate the expected monetary value for the conformance and nonconformance work required to deliver the expected conforming output. When flowcharts are used to represent the steps in a process, they are sometimes called process flows or process flow diagrams and they can be used for process improvement as well as identifying where quality defects can occur or where to incorporate quality checks. Logical data model. Logical data models are a visual representation of an organization's data, described in business language and independent of any specific technology. The logical data model can be used to identify where data integrity or other quality issues can arise. Matrix diagrams. Matrix diagrams help find the strength of relationships among different factors, causes, and objectives that exist between the rows and columns that form the matrix. Depending on how many factors may be compared, the project manager can use different shapes of matrix diagrams; for example, L, T, Y, X, C, and roof–shaped. In this process they facilitate identifying the key quality metrics that are important for the success of the project. Mind mapping. Described in Section 5.2.2.3. Mind mapping is a diagrammatic method used to visually organizing information. A mind map in quality is often created around a single quality concept, drawn as an image in the center of a blank landscape page, to which associated representations of ideas such as images, words, and parts of words are added. The mind-mapping technique may help in the rapid
  • 333.
    gathering of projectquality requirements, constraints, dependencies, and relationships. 8.1.2.6 TEST AND INSPECTION PLANNING During the planning phase, the project manager and the project team determine how to test or inspect the product, deliverable, or service to meet the stakeholders’ needs and expectations, as well as how to meet the goal for the product's performance and reliability. The tests and inspections are industry dependent and can include, for example, alpha and beta tests in software projects, strength tests in construction projects, inspection in manufacturing, and field tests and nondestructive tests in engineering. 8.1.2.7 MEETINGS Project teams may hold planning meetings to develop the quality management plan. Attendees can include the project manager, the project sponsor, selected project team members, selected stakeholders, anyone with responsibility for project quality management activities, and others as needed.
  • 334.
    8.1.3 PLAN QUALITYMANAGEMENT: OUTPUTS 8.1.3.1 QUALITY MANAGEMENT PLAN The quality management plan is a component of the project management plan that describes how applicable policies, procedures, and guidelines will be implemented to achieve the quality objectives. It describes the activities and resources necessary for the project management team to achieve the quality objectives set for the project. The quality management plan may be formal or informal, detailed, or broadly framed. The style and detail of the quality management plan are determined by the requirements of the project. The quality management plan should be reviewed early in the project to ensure that decisions are based on accurate information. The benefits of this review can include a sharper focus on the project's value proposition, reductions in costs, and less frequent schedule overruns that are caused by rework. The quality management plan may include but is not limited to the following components: Quality standards that will be used by the project; Quality objectives of the project; Quality roles and responsibilities; Project deliverables and processes subject to quality review; Quality control and quality management activities planned for the project; Quality tools that will be used for the project; and Major procedures relevant for the project, such as dealing with nonconformance, corrective actions procedures, and continuous improvement procedures. 8.1.3.2 QUALITY METRICS A quality metric specifically describes a project or product attribute and how the Control Quality process will verify compliance to it. Some examples of quality metrics include percentage of tasks completed on time, cost performance measured by CPI, failure rate, number of defects identified per day, total downtime per month, errors found per line of code, customer satisfaction scores, and percentage of requirements covered by the test plan as a measure of test coverage.
  • 335.
    8.1.3.3 PROJECT MANAGEMENTPLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Risk management plan. Described in Section 11.1.3.1. Decisions on the quality management approach may require changes to the agreed- upon approach to managing risk on the project, and these will be recorded in the risk management plan. Scope baseline. Described in Section 5.4.3.1. The scope baseline may change as a result of this process if specific quality management activities need to be added. The WBS dictionary also records quality requirements, which may need updating. 8.1.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered in the quality planning process. Requirements traceability matrix. Described in Section 5.2.3.2. Where quality requirements are specified by this process, they are recorded in the requirements traceability matrix. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. Stakeholder register. Described in Section 13.1.3.1. Where additional information on existing or new stakeholders is gathered as a result of this process, it is recorded in the stakeholder register. 8.2 MANAGE QUALITY Manage Quality is the process of translating the quality management plan into executable quality activities that incorporate the organization's quality policies into the project. The key benefits of this process are that it increases the probability of meeting the quality objectives as well as identifying ineffective
  • 336.
    processes and causesof poor quality. Manage Quality uses the data and results from the control quality process to reflect the overall quality status of the project to the stakeholders. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 8-7. Figure 8-8 depicts the data flow diagram of the process.
  • 337.
    Manage Quality issometimes called quality assurance, although Manage Quality has a broader definition than quality assurance as it is used in nonproject work. In project management, the focus of quality assurance is on the processes used in the project. Quality assurance is about using project processes effectively. It involves following and meeting standards to assure stakeholders that the final product will meet their needs, expectations, and requirements. Manage Quality includes all the quality assurance activities, and is also concerned with the product design aspects and process improvements. Manage Quality work will fall under the conformance work category in the cost of quality framework. The Manage Quality process implements a set of planned and systematic acts and processes defined within the project's quality management plan that helps to: Design an optimal and mature product by implementing specific design guidelines that address specific aspects of the product, Build confidence that a future output will be completed in a manner that meets the specified requirements and expectations through quality assurance tools and techniques such as quality audits and failure analysis,
  • 338.
    Confirm that thequality processes are used and that their use meets the quality objectives of the project, and Improve the efficiency and effectiveness of processes and activities to achieve better results and performance and enhance stakeholders’ satisfaction. The project manager and project team may use the organization's quality assurance department, or other organizational functions, to execute some of the Manage Quality activities such as failure analysis, design of experiments, and quality improvement. Quality assurance departments usually have cross- organizational experience in using quality tools and techniques and are a good resource for the project. Manage Quality is considered the work of everybody—the project manager, the project team, the project sponsor, the management of the performing organization, and even the customer. All of these have roles in managing quality in the project, though the roles differ in size and effort. The level of participation in the quality management effort may differ between industries and project management styles. In agile projects, quality management is performed by all team members throughout the project, but in traditional projects, quality management is often the responsibility of specific team members. 8.2.1 MANAGE QUALITY: INPUTS 8.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the quality management plan. Described in Section 8.1.3.1, the quality management plan defines the acceptable level of project and product quality and describes how to ensure this level of quality in its deliverables and processes. The quality management plan also describes what to do with nonconforming products and what corrective action to implement. 8.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to managing quality can be applied to
  • 339.
    later phases inthe project to improve the efficiency and effectiveness of managing quality. Quality control measurements. Described in Section 8.3.3.1. Quality control measurements are used to analyze and evaluate the quality of the processes and deliverables of the project against the standards of the performing organization or the requirements specified. Quality control measurements can also compare the processes used to create the measurements and validate actual measurements to determine their level of correctness. Quality metrics. Described in Section 8.1.3.2. Quality metrics are verified as part of the Control Quality process. The Manage Quality process uses these quality metrics as a basis for the development of test scenarios for the project and its deliverables and as a basis for improvement initiatives. Risk report. Described in Section 11.2.3.2. Risk report is used in the Manage Quality process to identify sources of overall project risk and the most important drivers of overall risk exposure that can impact the quality objectives of the project. 8.2.1.3 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Manage Quality process include but are not limited to: Organizational quality management system that includes policies, procedures, and guidelines; Quality templates such as check sheets, traceability matrix, test plans, test documents, and others; Results from previous audits; and Lessons learned repository with information from similar projects. 8.2.2 MANAGE QUALITY: TOOLS AND TECHNIQUES 8.2.2.1 DATA GATHERING A data-gathering technique that can be used for this process includes but is not limited to checklists (see Section 11.2.2.2). A checklist is a structured tool,
  • 340.
    usually component-specific, usedto verify that a set of required steps has been performed or to check if a list of requirements has been satisfied. Based on the project's requirements and practices, checklists may be simple or complex. Many organizations have standardized checklists available to ensure consistency in frequently performed tasks. In some application areas, checklists are also available from professional associations or commercial service providers. Quality checklists should incorporate the acceptance criteria included in the scope baseline. 8.2.2.2 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Alternatives analysis. Described in Section 9.2.2.5. This technique is used to evaluate identified options in order to select which different quality options or approaches are most appropriate to use. Document analysis. Described in Section 5.2.2.3. The analysis of different documents produced as part of the output of project control processes, such as quality reports, test reports, performance reports, and variance analysis, can point to and focus on processes that may be out of control and may jeopardize meeting the specified requirements or stakeholders’ expectations. Process analysis. Process analysis identifies opportunities for process improvements. This analysis also examines problems, constraints, and non-value-added activities that occur during a process. Root cause analysis (RCA). Root cause analysis is an analytical technique used to determine the basic underlying reason that causes a variance, defect, or risk. A root cause may underlie more than one variance, defect, or risk. It may also be used as a technique for identifying root causes of a problem and solving them. When all root causes for a problem are removed, the problem does not recur. 8.2.2.3 DECISION MAKING A decision-making technique that can be used for this process includes but is not limited to multicriteria decision analysis. Described in Section 8.1.2.4. Multicriteria decision making is used to evaluate several criteria when discussing alternatives that impact project or product quality. Project decisions can include
  • 341.
    choosing among differentimplementation scenarios or suppliers. Product decisions can include evaluating the life cycle cost, schedule, stakeholder satisfaction, and risks associated with resolving product defects. 8.2.2.4 DATA REPRESENTATION Data representation techniques that can be used for this process include but are not limited to: Affinity diagrams. Described in Section 5.2.2.5. Affinity diagrams can organize potential causes of defects into groups showing areas that should be focused on the most. Cause-and-effect diagrams. Cause-and-effect diagrams are also known as fishbone diagrams, why-why diagrams, or Ishikawa diagrams. This type of diagram breaks down the causes of the problem statement identified into discrete branches, helping to identify the main or root cause of the problem. Figure 8-9 is an example of a cause-and-effect diagram. Flowcharts. Described in Section 8.1.2.5. Flowcharts show a series of steps that lead to a defect. Histograms. Histograms show a graphical representation of numerical data. Histograms can show the number of defects per deliverable, a ranking of the cause of defects, the number of times each process is noncompliant, or other representations of project or product defects. Matrix diagrams. Described in Section 8.1.2.5. The matrix diagram seeks to show the strength of relationships among factors, causes, and objectives that exist between the rows and columns that form the matrix. Scatter diagrams. A scatter diagram is a graph that shows the relationship between two variables. Scatter diagrams can demonstrate a relationship between any element of a process, environment, or activity on one axis and a quality defect on the other axis.
  • 342.
    8.2.2.5 AUDITS An auditis a structured, independent process used to determine if project activities comply with organizational and project policies, processes, and procedures. A quality audit is usually conducted by a team external to the project, such as the organization's internal audit department, PMO, or by an auditor external to the organization. Quality audit objectives may include but are not limited to: Identifying all good and best practices being implemented; Identifying all nonconformity, gaps, and shortcomings; Sharing good practices introduced or implemented in similar projects in the organization and/or industry; Proactively offering assistance in a positive manner to improve the implementation of processes to help raise team productivity; and Highlighting contributions of each audit in the lessons learned repository of the organization. The subsequent effort to correct any deficiencies should result in a reduced cost of quality and an increase in sponsor or customer acceptance of the project's
  • 343.
    product. Quality auditsmay be scheduled or random, and may be conducted by internal or external auditors. Quality audits can confirm the implementation of approved change requests including updates, corrective actions, defect repairs, and preventive actions. 8.2.2.6 DESIGN FOR X Design for X (DfX) is a set of technical guidelines that may be applied during the design of a product for the optimization of a specific aspect of the design. DfX can control or even improve the product's final characteristics. The X in DfX can be different aspects of product development, such as reliability, deployment, assembly, manufacturing, cost, service, usability, safety, and quality. Using the DfX may result in cost reduction, quality improvement, better performance, and customer satisfaction. 8.2.2.7 PROBLEM SOLVING Problem solving entails finding solutions for issues or challenges. It can include gathering additional information, critical thinking, creative, quantitative and/or logical approaches. Effective and systematic problem solving is a fundamental element in quality assurance and quality improvement. Problems can arise as a result of the Control Quality process or from quality audits and can be associated with a process or deliverable. Using a structured problem-solving method will help eliminate the problem and develop a long-lasting solution. Problem-solving methods generally include the following elements: Defining the problem, Identifying the root-cause, Generating possible solutions, Choosing the best solution, Implementing the solution, and Verifying solution effectiveness. 8.2.2.8 QUALITY IMPROVEMENT METHODS Quality improvements can occur based on findings and recommendations from quality control processes, the findings of the quality audits, or problem solving in the Manage Quality process. Plan-do-check-act and Six Sigma are two of the most common quality improvement tools used to analyze and evaluate
  • 344.
    opportunities for improvement. 8.2.3MANAGE QUALITY: OUTPUTS 8.2.3.1 QUALITY REPORTS The quality reports can be graphical, numerical, or qualitative. The information provided can be used by other processes and departments to take corrective actions in order to achieve the project quality expectations. The information presented in the quality reports may include all quality management issues escalated by the team; recommendations for process, project, and product improvements; corrective actions recommendations (including rework, defect/bugs repair, 100% inspection, and more); and the summary of findings from the Control Quality process. 8.2.3.2 TEST AND EVALUATION DOCUMENTS Test and evaluation documents can be created based on industry needs and the organization's templates. They are inputs to the Control Quality process and are used to evaluate the achievement of quality objectives. These documents may include dedicated checklists and detailed requirements traceability matrices as part of the document. 8.2.3.3 CHANGE REQUESTS Described in Section 4.3.3.4. If changes occur during the Manage Quality process that impact any of the components of the project management plan, project documents, or project or product management processes, the project manager should submit a change request and follow the Perform Integrated Change Control process as defined in Section 4.6. 8.2.3.4 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Quality management plan. Described in Section 8.1.3.1. The agreed- upon approach to managing quality may need to be modified due to the actual results.
  • 345.
    Scope baseline. Describedin Section 5.4.3.1. The scope baseline may change as a result of specific quality management activities. Schedule baseline. Described in Section 6.5.3.1. The schedule baseline may change as a result of specific quality management activities. Cost baseline. Described in Section 7.3.3.1. The cost baseline may change as a result of specific quality management activities. 8.2.3.5 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. New issues raised as a result of this process are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well for the managing quality. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. 8.3 CONTROL QUALITY Control Quality is the process of monitoring and recording results of executing the quality management activities in order to assess performance and ensure the project outputs are complete, correct, and meet customer expectations. The key benefit of this process is verifying that project deliverables and work meet the requirements specified by key stakeholders for final acceptance. The Control Quality process determines if the project outputs do what they were intended to do. Those outputs need to comply with all applicable standards, requirements, regulations, and specifications. This process is performed throughout the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 8-10. Figure 8-11 depicts the data flow diagram of the process.
  • 347.
    The Control Qualityprocess is performed to measure the completeness, compliance, and fitness for use of a product or service prior to user acceptance and final delivery. This is done by measuring all steps, attributes, and variables used to verify conformance or compliance to the specifications stated during the planning stage. Quality control should be performed throughout the project to formally demonstrate, with reliable data, that the sponsor's and/or customer's acceptance criteria have been met. The level of effort to control quality and the degree of implementation may differ between industries and project management styles; in pharmaceutical, health, transportation, and nuclear industries, for example, there may be stricter quality control procedures compared to other industries, and the effort needed to meet the standards may be extensive. For example, in agile projects, the Control Quality activities may be performed by all team members throughout the project life cycle. In waterfall model-based projects, the quality control activities are performed at specific times, toward the end of the project or phase, by specified team members. 8.3.1 CONTROL QUALITY: INPUTS 8.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the quality management plan. Described in Section 8.1.3.1, the quality management plan defines how quality control will be performed within the project. 8.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve quality control. Quality metrics. Described in Section 8.1.3.2. A quality metric specifically describes a project or product attribute and how the Control Quality process will verify compliance to it.
  • 348.
    Test and evaluationdocuments. Described in Section 8.2.3.2. Test and evaluation documents are used to evaluate achievement of the quality objectives. 8.3.1.3 APPROVED CHANGE REQUESTS Described in Section 4.6.3.1. As part of the Perform Integrated Change Control process, a change log update indicates that some changes are approved and some are not. Approved change requests may include modifications such as defect repairs, revised work methods, and revised schedules. Partial change completion may result in inconsistencies and later delays due to incomplete steps or corrections. The implementation of approved changes should be verified, confirmed for completeness, retested, and certified as correct. 8.3.1.4 DELIVERABLES A deliverable is any unique and verifiable product, result, or capability to perform a service that is required to be produced to complete a process, phase, or project. Deliverables that are outputs from the Direct and Manage Project Work process are inspected and compared to the acceptance criteria defined in the project scope statement. 8.3.1.5 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on product status such as observations, quality metrics, and measurements for technical performance, as well as project quality information on schedule performance and cost performance. 8.3.1.6 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Control Quality process include but are not limited to: Project management information system; quality management software can be used to track errors and variations in processes or deliverables; Governmental agency regulations; and Rules, standards, and guidelines specific to the application area.
  • 349.
    8.3.1.7 ORGANIZATIONAL PROCESSASSETS The organizational process assets that can influence the Control Quality process include but are not limited to: Quality standards and policies; Quality templates, for example, check sheets, checklists, etc. and; Issue and defect reporting procedures and communication policies. 8.3.2 CONTROL QUALITY: TOOLS AND TECHNIQUES 8.3.2.1 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to: Checklists. Described in Section 11.2.2.2. Checklists help in managing the control quality activities in a structured manner. Check sheets. Check sheets are also known as tally sheets and are used to organize facts in a manner that will facilitate the effective collection of useful data about a potential quality problem. They are especially useful for gathering attributes data while performing inspections to identify defects; for example, data about the frequencies or consequences of defects collected. See Figure 8-12. Statistical sampling. Statistical sampling involves choosing part of a
  • 350.
    population of interestfor inspection (for example, selecting 10 engineering drawings at random from a list of 75). The sample is taken to measure controls and verify quality. Sample frequency and sizes should be determined during the Plan Quality Management process. Questionnaires and Surveys. Surveys may be used to gather data about customer satisfaction after the deployment of the product or service. The cost regarding defects identified in the surveys may be considered external failure costs in the COQ model and can have extensive cost implications for the organization. 8.3.2.2 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Performance reviews. Performance reviews measure, compare, and analyze the quality metrics defined by the Plan Quality Management process against the actual results. Root cause analysis (RCA). Described in Section 8.2.2.2. Root cause analysis is used to identify the source of defects. 8.3.2.3 INSPECTION An inspection is the examination of a work product to determine if it conforms to documented standards. The results of inspections generally include measurements and may be conducted at any level. The results of a single activity can be inspected, or the final product of the project can be inspected. Inspections may be called reviews, peer reviews, audits, or walkthroughs. In some application areas, these terms have narrow and specific meanings. Inspections also are used to verify defect repairs. 8.3.2.4 TESTING/PRODUCT EVALUATIONS Testing is an organized and constructed investigation conducted to provide objective information about the quality of the product or service under test in accordance with the project requirements. The intent of testing is to find errors, defects, bugs, or other nonconformance problems in the product or service. The type, amount, and extent of tests needed to evaluate each requirement are part of the project quality plan and depend on the nature of the project, time, budget, and other constraints. Tests can be performed throughout the project, as different
  • 351.
    components of theproject become available, and at the end of the project on the final deliverables. Early testing helps identify nonconformance problems and helps reduce the cost of fixing the nonconforming components. Different application areas require different tests. For example, software testing may include unit testing, integration testing, black-box, white-box, interface testing, regression testing, Alpha testing, etc. In construction projects, testing may include cement strength, concrete workability test, nondestructive tests at construction sites for testing the quality of hardened concrete structures, and soil tests. In hardware development, testing may include environmental stress screening, burn-in tests, system testing, and more. 8.3.2.5 DATA REPRESENTATION Data representation techniques that can be used for this process include but are not limited to: Cause-and-effect diagrams. Described in Section 8.2.2.4. Cause-and- effect diagrams are used to identify the possible effects of quality defects and errors. Control charts. Control charts are used to determine whether or not a process is stable or has predictable performance. Upper and lower specification limits are based on the requirements and reflect the maximum and minimum values allowed. Upper and lower control limits are different from specification limits. The control limits are determined using standard statistical calculations and principles to ultimately establish the natural capability for a stable process. The project manager and appropriate stakeholders may use the statistically calculated control limits to identify the points at which corrective action will be taken to prevent performance that remains outside the control limits. Control charts can be used to monitor various types of output variables. Although used most frequently to track repetitive activities required for producing manufactured lots, control charts may also be used to monitor cost and schedule variances, volume, frequency of scope changes, or other management results to help determine if the project management processes are in control. Histograms. Described in Section 8.2.2.4. Histograms can demonstrate the number of defects by source or by component. Scatter diagrams. Described in Section 8.2.2.4. Scatter diagrams can
  • 352.
    show the plannedperformance on one axis and the actual performance on the second axis. 8.3.2.6 MEETINGS The following meetings may be used as part of the Control Quality process: Approved change requests review. All approved change requests should be reviewed to verify that they were implemented as approved. This review should also check that partial changes are completed and all parts have been properly implemented, tested, completed, and certified. Retrospectives/lesson learned. A meeting held by a project team to discuss: Successful elements in the project/phase, What could be improved, What to incorporate in the ongoing project and what in future projects, and What to add to the organization process assets. 8.3.3 CONTROL QUALITY: OUTPUTS 8.3.3.1 QUALITY CONTROL MEASUREMENTS Quality control measurements are the documented results of Control Quality activities. They should be captured in the format that was specified in the quality management plan. 8.3.3.2 VERIFIED DELIVERABLES A goal of the Control Quality process is to determine the correctness of deliverables. The results of performing the Control Quality process are verified deliverables that become an input to the Validate Scope process (Section 5.5) for formalized acceptance. If there were any change requests or improvements related to the deliverables, they may be changed, inspected, and reverified. 8.3.3.3 WORK PERFORMANCE INFORMATION
  • 353.
    Described in Section4.5.1.3. Work performance information includes information on project requirements fulfillment, causes for rejections, rework required, recommendations for corrective actions, lists of verified deliverables, status of the quality metrics, and the need for process adjustments. 8.3.3.4 CHANGE REQUESTS Described in Section 4.3.3.4. If changes occur during the Control Quality process that may impact any of the components of the project management plan or project documents, the project manager should submit a change request. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 8.3.3.5 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to the quality management plan, as described in Section 8.1.3.1. 8.3.3.6 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. Many times a deliverable that does not meet the quality requirements is documented as an issue. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on the source of quality defects and how they could have been avoided as well as approaches that worked well. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. Test and evaluation documents. Described in Section 8.2.3.2. Test and evaluation documents may be modified as a result of this process in order to make future tests more effective.
  • 354.
    9 PROJECT RESOURCE MANAGEMENT ProjectResource Management includes the processes to identify, acquire, and manage the resources needed for the successful completion of the project. These processes help ensure that the right resources will be available to the project manager and project team at the right time and place. The Project Resource Management processes are: 9.1 Plan Resource Management—The process of defining how to estimate, acquire, manage, and utilize physical and team resources. 9.2 Estimate Activity Resources—The process of estimating team resources and the type and quantities of material, equipment, and supplies necessary to perform project work. 9.3 Acquire Resources—The process of obtaining team members, facilities, equipment, materials, supplies, and other resources necessary to complete project work. 9.4 Develop Team—The process of improving competencies, team member interaction, and the overall team environment to enhance project performance. 9.5 Manage Team—The process of tracking team member performance, providing feedback, resolving issues, and managing team changes to optimize project performance. 9.6 Control Resources—The process of ensuring that the physical resources assigned and allocated to the project are available as planned, as well as monitoring the planned versus actual use of resources, and performing corrective action as necessary. Figure 9-1 provides an overview of the Project Resource Management processes. The Project Resource Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 355.
    There is adistinction between the skills and competencies needed for the project manager to manage team resources versus physical resources. Physical resources include equipment, materials, facilities, and infrastructure. Team resources or personnel refer to the human resources. Personnel may have varied skill sets, may be assigned full- or part-time, and may be added or removed from the project team as the project progresses. There is some overlap between Project Resource Management and Project Stakeholder Management (Section 13). This section (Section 9) focuses on the subset of stakeholders who make up the project team. KEY CONCEPTS FOR PROJECT RESOURCE MANAGEMENT The project team consists of individuals with assigned roles and responsibilities who work collectively to achieve a shared project goal. The
  • 356.
    project manager shouldinvest suitable effort in acquiring, managing, motivating, and empowering the project team. Although specific roles and responsibilities for the project team members are assigned, the involvement of all team members in project planning and decision making is beneficial. Participation of team members during planning adds their expertise to the process and strengthens their commitment to the project. The project manager should be both leader and manager of the project team. In addition to project management activities such as initiating, planning, executing, monitoring and controlling, and closing the various project phases, the project manager is responsible for the team formation as an effective group. The project manager should be aware of different aspects that influence the team, such as: Team environment, Geographical locations of team members, Communications among stakeholders, Organizational change management, Internal and external politics, Cultural issues and organizational uniqueness, and Other factors that may alter project performance. As a leader, the project manager is also responsible for proactively developing team skills and competencies while retaining and improving team satisfaction and motivation. The project manager should be aware of, and subscribe to, professional and ethical behavior, and ensure that all team members adhere to these behaviors. Physical resource management is concentrated in allocating and using the physical resources (material, equipment, and supplies, for example) needed for successful completion of the project in an efficient and effective way. In order to do that, organizations should have data on resource demands (now and in the reasonable future), resource configurations that will be required to meet those demands, and the supply of resources. Failing to manage and control resources efficiently is a source of risk for successful project completion. For example: Failing to secure critical equipment or infrastructure on time may result in delays in the manufacturing of the final product, Ordering low-quality material may damage the quality of the product
  • 357.
    causing a highrate of recalls or rework, and Keeping too much inventory may result in high operations costs and reduce the organization's profit. Unacceptably low inventory level, on the other hand, may result in not satisfying customer demand and, again, reduce the organization's profit. TRENDS AND EMERGING PRACTICES IN PROJECT RESOURCE MANAGEMENT Project management styles are shifting away from a command and control structure for managing projects and toward a more collaborative and supportive management approach that empowers teams by delegating decision making to the team members. In addition, modern project resource management approaches seek to optimize resource utilization. Trends and emerging practices for Project Resource Management include but are not limited to: Resource management methods. Due to the scarce nature of critical resources, in some industries, several trends have become popular in the past several years. There is extensive literature about lean management, just-in-time (JIT) manufacturing, Kaizen, total productive maintenance (TPM), theory of constraints (TOC), and other methods. A project manager should determine if the performing organization has adopted one or more resource management tools and adapt the project accordingly. Emotional intelligence (EI). The project manager should invest in personal EI by improving inbound (e.g., self-management and self- awareness) and outbound (e.g., relationship management) competencies. Research suggests that project teams that succeed in developing team EI or become an emotionally competent group are more effective. Additionally, there is a reduction in staff turnover. Self-organizing teams. The increase in using agile approaches mainly for the execution of IT projects has given rise to the self-organizing team, where the team functions with an absence of centralized control. In projects that have self-organizing teams, the project manager (who may not be called a project manager) role provides the team with the environment and support needed and trusts the team to get the job done. Successful self-organizing teams usually consist of generalized specialists, instead of subject matter experts, who continuously adapt to the changing environment and embrace constructive feedback.
  • 358.
    Virtual teams/distributed teams.The globalization of projects has promoted the need for virtual teams that work on the same project, but are not colocated at the same site. The availability of communication technology such as email, audio conferencing, social media, web- based meetings, and video conferencing has made virtual teams feasible. Managing virtual teams has unique advantages, such as being able to use special expertise on a project team even when the expert is not in the same geographic area, incorporating employees who work from home offices, and including people with mobility limitations or disabilities. The challenges of managing virtual teams are mainly in the communication domain, including a possible feeling of isolation, gaps in sharing knowledge and experience between team members, and difficulties in tracking progress and productivity, possible time zone difference and cultural differences. TAILORING CONSIDERATIONS Because each project is unique, the project manager will need to tailor the way Project Resource Management processes are applied. Considerations for tailoring include but are not limited to: Diversity. What is the diversity background of the team? Physical location. What is the physical location of team members and physical resources? Industry-specific resources. What special resources are needed in the industry? Acquisition of team members. How will team members be acquired for the project? Are team resources full-time or part-time on the project? Management of team. How is team development managed for the project? Are there organizational tools to manage team development or will new ones need to be established? Are there team members who have special needs? Will the team need special training to manage diversity? Life cycle approaches. What life cycle approach will be used on the project? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS
  • 359.
    Projects with highvariability benefit from team structures that maximize focus and collaboration, such as self-organizing teams with generalizing specialists. Collaboration is intended to boost productivity and facilitate innovative problem solving. Collaborative teams may facilitate accelerated integration of distinct work activities, improve communication, increase knowledge sharing, and provide flexibility of work assignments in addition to other advantages. Although the benefits of collaboration also apply to other project environments, collaborative teams are often critical to the success of projects with a high degree of variability and rapid changes, because there is less time for centralized tasking and decision making. Planning for physical and human resources is much less predictable in projects with high variability. In these environments, agreements for fast supply and lean methods are critical to controlling costs and achieving the schedule. 9.1 PLAN RESOURCE MANAGEMENT Plan Resource Management is the process of defining how to estimate, acquire, manage, and use team and physical resources. The key benefit of this process is that it establishes the approach and level of management effort needed for managing project resources based on the type and complexity of the project. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 9-2. Figure 9-3 depicts the data flow diagram for the process.
  • 360.
    Resource planning isused to determine and identify an approach to ensure that sufficient resources are available for the successful completion of the project. Project resources may include team members, supplies, materials, equipment, services and facilities. Effective resource planning should consider
  • 361.
    and plan forthe availability of, or competition for, scarce resources. Those resources can be obtained from the organization's internal assets or from outside the organization through a procurement process. Other projects may be competing for the same resources required for the project at the same time and location. This may significantly impact project costs, schedules, risks, quality, and other project areas. 9.1.1 PLAN RESOURCE MANAGEMENT: INPUTS 9.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter provides the high-level project description and requirements. It also has the key stakeholder list, summary milestones, and preapproved financial resources that may influence the resource management of the project. 9.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Quality management plan. Described in Section 8.1.3.1. The quality management plan helps define the level of resources that will be required to achieve and maintain the defined level of quality and achieve the metrics for the project. Scope baseline. Described in Section 5.4.3.1. The scope baseline identifies the deliverables that drive the types and quantities of resources that will need to be managed. 9.1.1.3 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Project schedule. Described in Section 6.5.3.2. The project schedule shows the timeline for needed resources. Requirements documentation. Described in Section 5.2.3.1. Requirements will dictate the type and amount of resources needed for the project and may influence how they are managed.
  • 362.
    Risk register. Describedin Section 11.2.3.1. The risk register contains information on threats and opportunities that may impact resource planning. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register aids in identifying those stakeholders who have a particular interest in or an impact on resources needed for the project. It also helps to identify stakeholders who can influence the use of one kind of resource over another. 9.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Resource Management include but are not limited to: Organizational culture and structure, Geographic distribution of facilities and resources, Existing resources competencies and availability, and Marketplace conditions. 9.1.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Resource Management include but are not limited to: Human resource policies and procedures, Physical resource management policies and procedures, Safety policies, Security policies, Templates for the resource management plan, and Historical information for similar projects. 9.1.2 PLAN RESOURCE MANAGEMENT: TOOLS AND TECHNIQUES 9.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals
  • 363.
    or groups withspecialized knowledge or training in the following topics: Negotiating for the best resources within the organization; Talent management and personnel development; Determining the preliminary effort level needed to meet project objectives; Determining reporting requirements based on the organizational culture; Estimating lead times required for acquisition, based on lessons learned and market conditions; Identifying risks associated with resource acquisition, retention, and release plans; Complying with applicable government and union regulations; and Managing sellers and the logistics effort to ensure materials and supplies are available when needed. 9.1.2.2 DATA REPRESENTATION Data representation techniques that can be used for this process include but are not limited to charts. Various formats exist to document and communicate team member roles and responsibilities. Most fall into hierarchical, matrix, or text-oriented formats. Some project assignments are listed in subsidiary plans, such as the risk, quality, or communications management plans. Regardless of the method used to document team member roles, the objective is to ensure that each work package has an unambiguous owner and that all team members have a clear understanding of their roles and responsibilities. A hierarchical format may be used to represent high-level roles, while a text-based format may be better suited to document the detailed responsibilities. Hierarchical charts. The traditional organizational chart structure can be used to show positions and relationships in a graphical, top-down format. Work breakdown structures (WBS). The WBS is designed to show how project deliverables are broken down into work packages and provide a way of showing high-level areas of responsibility. Organizational breakdown structure (OBS). While the WBS shows a breakdown of project deliverables, an OBS is arranged according to
  • 364.
    an organization's existingdepartments, units, or teams, with the project activities or work packages listed under each department. An operational department, such as information technology or purchasing, can see all of its project responsibilities by looking at its portion of the OBS. Resource breakdown structure. The resource breakdown structure is a hierarchical list of team and physical resources related by category and resource type that is used for planning, managing and controlling project work. Each descending (lower) level represents an increasingly detailed description of the resource until the information is small enough to be used in conjunction with the work breakdown structure (WBS) to allow the work to be planned, monitored, and controlled. Assignment Matrix. A RAM shows the project resources assigned to each work package. It is used to illustrate the connections between work packages, or activities, and project team members. On larger projects, RAMs can be developed at various levels. For example, a high-level RAM can define the responsibilities of a project team, group, or unit within each component of the WBS. Lower-level RAMs are used within the group to designate roles, responsibilities, and levels of authority for specific activities. The matrix format shows all activities associated with one person and all people associated with one activity. This also ensures that there is only one person accountable for any one task to avoid confusion about who is ultimately in charge or has authority for the work. One example of a RAM is a RACI (responsible, accountable, consult, and inform) chart, shown in Figure 9-4. The sample chart shows the work to be done in the left column as activities. The assigned resources can be shown as individuals or groups. The project manager can select other options, such as “lead” and “resource” designations, as appropriate for the project. A RACI chart is a useful tool to use to ensure clear assignment of roles and responsibilities when the team consists of internal and external resources. Text-oriented formats. Team member responsibilities that require detailed descriptions can be specified in text-oriented formats. Usually in outline form, these documents provide information such as responsibilities, authority, competencies, and qualifications. The
  • 365.
    documents are knownby various names including position descriptions and role-responsibility-authority forms. These documents can be used as templates for future projects, especially when the information is updated throughout the current project by applying lessons learned. 9.1.2.3 ORGANIZATIONAL THEORY Organizational theory provides information regarding the way in which people, teams, and organizational units behave. Effective use of common techniques identified in organizational theory can shorten the amount of time, cost, and effort needed to create the Plan Resource Management process outputs and improve planning efficiency. Applicable organizational theories may recommend exercising a flexible leadership style that adapts to the changes in a team's maturity level throughout the project life cycle. It is important to recognize that the organization's structure and culture impacts the project organizational structure. 9.1.2.4 MEETINGS The project team may hold meetings to plan resource management for the project. 9.1.3 PLAN RESOURCE MANAGEMENT: OUTPUTS
  • 366.
    9.1.3.1 RESOURCE MANAGEMENTPLAN The resource management plan is the component of the project management plan that provides guidance on how project resources should be categorized, allocated, managed, and released. It may be divided between the team management plan and physical resource management plan according to the specifics of the project. The resource management plan may include but is not limited to: Identification of resources. Methods for identifying and quantifying team and physical resources needed. Acquiring resources. Guidance on how to acquire team and physical resources for the project. Roles and responsibilities: Role. The function assumed by, or assigned to, a person in the project. Examples of project roles are civil engineer, business analyst, and testing coordinator. Authority. The rights to apply project resources, make decisions, sign approvals, accept deliverables, and influence others to carry out the work of the project. Examples of decisions that need clear authority include the selection of a method for completing an activity, quality acceptance criteria, and how to respond to project variances. Team members operate best when their individual levels of authority match their individual responsibilities. Responsibility. The assigned duties and work that a project team member is expected to perform in order to complete the project's activities. Competence. The skill and capacity required to complete assigned activities within the project constraints. If project team members do not possess required competencies, performance can be jeopardized. When such mismatches are identified, proactive responses such as training, hiring, schedule changes, or scope changes are initiated. Project organization charts. A project organization chart is a graphic display of project team members and their reporting relationships. It can be formal or informal, highly detailed or broadly framed, based on the needs of the project. For example, the project organization chart for a 3,000-person disaster response team will have greater detail than
  • 367.
    a project organizationchart for an internal, 20-person project. Project team resource management. Guidance on how project team resources should be defined, staffed, managed, and eventually released. Training. Training strategies for team members. Team development. Methods for developing the project team. Resource control. Methods for ensuring adequate physical resources are available as needed and that the acquisition of physical resources is optimized for project needs. Includes information on managing inventory, equipment, and supplies during throughout the project life cycle. Recognition plan. Which recognition and rewards will be given to team members, and when they will be given. 9.1.3.2 TEAM CHARTER The team charter is a document that establishes the team values, agreements, and operating guidelines for the team. The team charter may include but is not limited to: Team values, Communication guidelines, Decision-making criteria and process, Conflict resolution process, Meeting guidelines, and Team agreements. The team charter establishes clear expectations regarding acceptable behavior by project team members. Early commitment to clear guidelines decreases misunderstandings and increases productivity. Discussing areas such as codes of conduct, communication, decision making, and meeting etiquette allows team members to discover values that are important to one another. The team charter works best when the team develops it, or at least has an opportunity to contribute to it. All project team members share responsibility for ensuring the rules documented in the team charter are followed. The team charter can be reviewed and updated periodically to ensure a continued understanding of the team ground rules and to orient and integrate new team members.
  • 368.
    9.1.3.3 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log is updated with assumptions regarding the availability, logistics requirements, and location of physical resources as well as the skill sets and availability of team resources. Risk register. Described in Section 11.2.3.1. The risk register is updated with risks associated with team and physical resource availability or other known resource-related risks. 9.2 ESTIMATE ACTIVITY RESOURCES Estimate Activity Resources is the process of estimating team resources and the type and quantities of materials, equipment, and supplies necessary to perform project work. The key benefit of this process is that it identifies the type, quantity, and characteristics of resources required to complete the project. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of this process are depicted in Figure 9-5. Figure 9-6 depicts the data flow diagram of the process.
  • 369.
    The Estimate ActivityResources process is closely coordinated with other processes, such as the Estimate Costs process. For example: A construction project team will need to be familiar with local building codes. Such knowledge is often readily available from local sellers. If the internal labor pool lacks experience with unusual or specialized construction techniques, the additional cost for a consultant may be the most effective way to secure knowledge of the local building codes. An automotive design team will need to be familiar with the latest automated assembly techniques. The requisite knowledge could be obtained by hiring a consultant, by sending a designer to a seminar on robotics, or by including someone from manufacturing as a member of the project team. 9.2.1 ESTIMATE ACTIVITY RESOURCES: INPUTS 9.2.1.1 PROJECT MANAGEMENT PLAN
  • 370.
    Described in Section4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan defines the approach to identify the different resources needed for the project. It also defines the methods to quantify the resources needed for each activity and aggregates this information. Scope baseline. Described in Section 5.4.3.1. The scope baseline identifies the project and product scope necessary to meet the project objectives. The scope drives the needs for both team and physical resources. 9.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. Activity attributes provide the primary data source for use in estimating team and physical resources required for each activity on the activity list. Examples of attributes include the resource requirements, imposed dates, activity location, assumptions, and constraints. Activity list. Described in Section 6.2.3.1. The activity list identifies the activities that will need resources. Assumption log. Described in Section 4.1.3.2. The assumption log may have information on productivity factors, availability, cost estimates, and approaches to work that will influence the nature and number of team and physical resources. Cost estimates. Described in Section 7.2.3.1. The cost of resources may impact resource selection from the quantity and skill level perspectives. Resource calendars. A resource calendar identifies the working days, shifts, start and end of normal business hours, weekends, and public holidays when each specific resource is available. Information on which resources (such as team resource, equipment, and material) are potentially available during a planned activity period is used for estimating resource utilization. Resource calendars also specify when,
  • 371.
    and for howlong, identified team and physical resources will be available during the project. This information may be at the activity or project level. This includes consideration of attributes such as resource experience and/or skill level, as well as various geographical locations. Risk register. Described in Section 11.2.3.1. The risk register describes the individual risks that can impact resource selection and availability. 9.2.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Estimate Activity Resources process include but are not limited to: Resource location, Resource availability, Team resource skills, Organizational culture, Published estimating data, and Marketplace conditions. 9.2.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Estimate Activity Resources process include but are not limited to: Policies and procedures regarding staffing, Policies and procedures relating to supplies and equipment, and Historical information regarding types of resources used for similar work on previous projects. 9.2.2 ESTIMATE ACTIVITY RESOURCES: TOOLS AND TECHNIQUES 9.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in team and physical resource planning and estimating.
  • 372.
    9.2.2.2 BOTTOM-UP ESTIMATING Describedin Section 6.4.2.5. Team and physical resources are estimated at the activity level and then aggregated to develop the estimates for work packages, control accounts, and summary project levels. 9.2.2.3 ANALOGOUS ESTIMATING Described in Section 6.4.2.2. Analogous estimating uses information regarding resources from a previous similar project as the basis for estimating a future project. It is used as quick estimating method and can be used when the project manager can only identify a few top levels of the WBS. 9.2.2.4 PARAMETRIC ESTIMATING Described in Section 6.4.2.3. Parametric estimating uses an algorithm or a statistical relationship between historical data and other variables to calculate resource quantities needed for an activity, based on historical data and project parameters. For example, if an activity needs 4,000 hours of coding and it needs to finish it in 1 year, it will require two people to code (each doing 2,000 hours a year). This technique can produce higher levels of accuracy depending on the sophistication and underlying data built into the model. 9.2.2.5 DATA ANALYSIS A data analysis technique used in this process includes but is not limited to alternatives analysis. Alternatives analysis is used to evaluate identified options in order to select the options or approaches to use to execute and perform the work of the project. Many activities have multiple options for accomplishment. They include using various levels of resource capability or skills, different sizes or types of machines, different tools (manual versus automated), and make-rent- or-buy decisions regarding the resources. Alternatives analysis assists in providing the best solution to perform the project activities, within the defined constraints. 9.2.2.6 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems can include resource management software that can help plan, organize, and manage resource pools and develop resource estimates. Depending on the sophistication of the software, resource breakdown structures, resource availability, resource
  • 373.
    rates, and variousresource calendars can be defined to assist in optimizing resource utilization. 9.2.2.7 MEETINGS The project manager may hold planning meetings with functional managers to estimate the resources needed per activity, level of effort (LoE), skill level of the team resources, and the quantity of the materials needed. Participants at these meetings may include the project manager, the project sponsor, selected project team members, selected stakeholders, and others as needed. 9.2.3 ESTIMATE ACTIVITY RESOURCES: OUTPUTS 9.2.3.1 RESOURCE REQUIREMENTS Resource requirements identify the types and quantities of resources required for each work package or activity in a work package and can be aggregated to determine the estimated resources for each work package, each WBS branch, and the project as a whole. The amount of detail and the level of specificity of the resource requirement descriptions can vary by application area. The resource requirements’ documentation can include assumptions that were made in determining which types of resources are applied, their availability, and what quantities are needed. 9.2.3.2 BASIS OF ESTIMATES Described in Section 6.4.3.2. The amount and type of additional details supporting the resource estimate vary by application area. Regardless of the level of detail, the supporting documentation should provide a clear and complete understanding of how the resource estimate was derived. Supporting detail for resource estimates may include: Method used to develop the estimate, Resources used to develop the estimate (such as information from previous similar projects), Assumptions associated with the estimate, Known constraints, Range of estimates,
  • 374.
    Confidence level ofthe estimate, and Documentation of identified risks influencing the estimate. 9.2.3.3 RESOURCE BREAKDOWN STRUCTURE The resource breakdown structure is a hierarchical representation of resources by category and type (see Figure 9-7 for example). Examples of resource categories include but are not limited to labor, material, equipment, and supplies. Resource types may include the skill level, grade level, required certifications, or other information as appropriate to the project. In Plan Resource Management, the resource breakdown structure was used to guide the categorization for the project. In this process it is a completed document that will be used to acquire and monitor resources. 9.2.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Activity attributes. Described in Section 6.2.3.2. The activity attributes are updated with the resource requirements. Assumption log. Described in Section 4.1.3.2. The assumption log is updated with assumptions regarding the types and quantities of resources required. Additionally, any resource constraints are entered including collective bargaining agreements, continuous hours of
  • 375.
    operation, planned leave,etc. Lessons learned register. Described in Section 11.2.3.1. The lessons learned register can be updated with techniques that were efficient and effective in developing resource estimates, and information on those techniques that were not efficient or effective. 9.3 ACQUIRE RESOURCES Acquire Resources is the process of obtaining team members, facilities, equipment, materials, supplies, and other resources necessary to complete project work. The key benefit of this process is that it outlines and guides the selection of resources and assigns them to their respective activities. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of the process are depicted in Figure 9-8. Figure 9-9 depicts the data flow diagram for the process.
  • 376.
    The resources neededfor the project can be internal or external to the project- performing organization. Internal resources are acquired (assigned) from functional or resource managers. External resources are acquired through the procurement processes. The project management team may or may not have direct control over resource selection because of collective bargaining agreements, use of subcontractor personnel, a matrix project environment, internal or external reporting relationships, or other reasons. It is important that the following factors are considered during the process of acquiring the project resources: The project manager or project team should effectively negotiate and influence others who are in a position to provide the required team and physical resources for the project. Failure to acquire the necessary resources for the project may affect project schedules, budgets, customer satisfaction, quality, and risks. Insufficient resources or capabilities decrease the probability of success and, in a worst-case scenario, could result in project cancellation.
  • 377.
    If the teamresources are not available due to constraints such as economic factors or assignment to other projects, the project manager or project team may be required to assign alternative resources, perhaps with different competencies or costs. Alternative resources are allowed provided there is no violation of legal, regulatory, mandatory, or other specific criteria. These factors should be considered and accounted for in the planning stages of the project. The project manager or project management team will be required to document the impact of the unavailability of required resources in the project schedule, project budget, project risks, project quality, training plans, and other project management plans. 9.3.1 ACQUIRE RESOURCES: INPUTS 9.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan provides guidance on how to acquire resources for the project. Procurement management plan. Described in Section 12.1.3.1. The procurement management plan has information regarding resources that will be acquired from outside the project. This includes information on how procurements will be integrated with other project work and stakeholders involved in procuring resources. Cost baseline. Described in Section 7.3.3.1. The cost baseline provides the overall budget for the project activities. 9.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Project schedule. Described in Section 6.5.3.2. The project schedule shows the activities and their planned start and end dates to help determine when the resources need to be available and acquired.
  • 378.
    Resource calendars. Describedin Section 9.3.3.3. Resource calendars document the time periods that each resource needed for the project is available for the project. Creating a reliable schedule depends on having a good understanding of each resource's availability and schedule constraints, including time zones, work hours, vacation time, local holidays, maintenance schedule and commitments to other projects. Resource calendars are progressively elaborated and updated throughout the project. Once created as an output of this process, they are used as needed whenever this process is repeated. Resource requirements. Described in Section 9.2.3.1. Resource requirements identify which resources need to be acquired. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register may reveal stakeholders’ needs or expectations for specific resources to be used on the project that need to be considered in the Acquire Resources process. 9.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Acquire Resources process include but are not limited to: Existing information on organizational resources including availability, competence levels, and prior experience for team resources and resource costs; Marketplace conditions; Organizational structure; and Geographic locations. 9.3.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Acquire Resources process include but are not limited to: Policies and procedures for acquiring, allocating, and assigning resources to the project; and Historical information and lessons learned repository.
  • 379.
    9.3.2 ACQUIRE RESOURCES:TOOLS AND TECHNIQUES 9.3.2.1 DECISION MAKING Described in Section 5.2.2.4. Decision-making techniques that can be used in the Acquire Resources process include but are not limited to multicriteria decision analysis, as described in Section 8.1.2.4. Selection criteria are often used to select physical project resources, or the project team. Using a multicriteria decision analysis tool, criteria are developed and used to rate or score potential resources (for example, choosing between internal and external team resources). The criteria are weighted according to their relative importance and values can be changed for different types of resources. Some examples of selection criteria that can be used are: Availability. Verify that the resource is available to work on the project within the time period needed. Cost. Verify if the cost of adding the resource is within the prescribed budget. Ability. Verify that the team member provides the capability needed by the project. Some selection criteria that are unique for team resources are: Experience. Verify that the team member has the relevant experience that will contribute to the project success. Knowledge. Consider if the team member has relevant knowledge of the customer, similar implemented projects, and nuances of the project environment. Skills. Determine if the team member has the relevant skills to use a project tool. Attitude. Determine if the team member has the ability to work with others as a cohesive team. International factors. Consider team member location, time zone, and communication capabilities. 9.3.2.2 INTERPERSONAL AND TEAM SKILLS An interpersonal and team skill that can be used for this process includes but is not limited to negotiation. Described in Section 12.2.2.5. Many projects need
  • 380.
    to negotiate forrequired resources. The project management team may need to negotiate with: Functional managers. Ensure that the project receives the best resources possible in the required timeframe and until their responsibilities are complete. Other project management teams within the performing organization. Appropriately assign or share scarce or specialized resources. External organizations and suppliers. Provide appropriate, scarce, specialized, qualified, certified, or other specific team or physical resources. Special consideration should be given to external negotiating policies, practices, processes, guidelines, legal, and other such criteria. The project management team's ability to influence others plays an important role in negotiating resource allocation, as does the politics of the organizations involved. For example, convincing a functional manager about the high visibility of the project may influence him or her to assign the best resources to this project over competing ones. 9.3.2.3 PRE-ASSIGNMENT When physical or team resources for a project are determined in advance, they are considered pre-assigned. This situation can occur if the project is the result of specific resources being identified as part of a competitive proposal or if the project is dependent upon the expertise of particular persons. Pre-assignment might also include the team members who have already been assigned in Develop Project Charter Process or other processes before the initial Resource Management Plan has been completed. 9.3.2.4 VIRTUAL TEAMS The use of virtual teams creates new possibilities when acquiring project team members. Virtual teams can be defined as groups of people with a shared goal who fulfill their roles with little or no time spent meeting face to face. The availability of communication technology such as email, audio conferencing, social media, web-based meetings, and video conferencing has made virtual teams feasible. The virtual team model makes it possible to: Form teams of people from the same organization who live in
  • 381.
    widespread geographic areas; Addspecial expertise to a project team even though the expert is not in the same geographic area; Incorporate employees who work from home offices; Form teams of people who work different shifts, hours, or days; Include people with mobility limitations or disabilities; Move forward with projects that would have been held or canceled due to travel expenses; and Save the expense of offices and all physical equipment needed for employees. Communication planning becomes increasingly important in a virtual team environment. Additional time may be needed to set clear expectations, facilitate communications, develop protocols for resolving conflict, include people in decision making, understand cultural differences, and share credit in successes. 9.3.3 ACQUIRE RESOURCES: OUTPUTS 9.3.3.1 PHYSICAL RESOURCE ASSIGNMENTS Documentation of the physical resource assignments records the material, equipment, supplies, locations, and other physical resources that will be used during the project. 9.3.3.2 PROJECT TEAM ASSIGNMENTS Documentation of team assignments records the team members and their roles and responsibilities for the project. Documentation can include a project team directory and names inserted into the project management plan, such as the project organization charts and schedules. 9.3.3.3 RESOURCE CALENDARS A resource calendar identifies the working days, shifts, start and end of normal business hours, weekends, and public holidays when each specific resource is available. Information on which resources (such as team resource, equipment, and material) are potentially available during a planned activity period is used for estimating resource utilization. Resource calendars also
  • 382.
    specify when andfor how long identified team and physical resources will be available during the project. This information may be at the activity or project level. This includes consideration of attributes such as resource experience and/or skill level, as well as various geographical locations. 9.3.3.4 CHANGE REQUESTS Described in Section 4.3.3.4. When changes occur as a result of carrying out the Acquire Resources process (for example, impacts to the schedule) or when recommended corrective or preventive actions impact any of the components of the project management plan or project documents, the project manager needs to submit a change request. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 9.3.3.5 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components of the project management plan that may be updated as a result of carrying out this process include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan may be updated to reflect actual experience in acquiring resources for the project, including lessons learned in acquiring resources early in the project that will impact how resources are acquired later in the project. Cost baseline. Described in Section 7.3.3.1. The cost baseline may change as a result of the acquisition of resources for the project. 9.3.3.6 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well for acquiring resources. Project schedule. Described in Section 6.5.3.2. Changes to the project
  • 383.
    schedule may resultfrom the availability of required resources. Resource breakdown structure. Described in Section 9.2.3.3. Resources acquired during this process are recorded in the resource breakdown structure. Resource requirements. Described in Section 9.2.3.1. Resource requirements documentation is updated to reflect resources acquired for the project. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register is updated with any new stakeholders and any new information about existing stakeholders that has been gained as a result of this process. 9.3.3.7 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES Enterprise environmental factors that are updated include but are not limited to: Resource availability within the organization, and Amount of the organization's consumable resources that have been used. 9.3.3.8 ORGANIZATIONAL PROCESS ASSETS UPDATES Organizational process assets that are updated as a result of the Acquire Resources process include but are not limited to documentation related to acquiring, assigning and allocating resources. 9.4 DEVELOP TEAM Develop Team is the process of improving competencies, team member interaction, and the overall team environment to enhance project performance. The key benefit of this process is that it results in improved teamwork, enhanced interpersonal skills and competencies, motivated employees, reduced attrition, and improved overall project performance. This process is performed throughout the project.
  • 384.
    The inputs, toolsand techniques, and outputs of the process are depicted in Figure 9-10. Figure 9-11 depicts the data flow diagram for the process. Project managers require the skills to identify, build, maintain, motivate, lead,
  • 385.
    and inspire projectteams to achieve high team performance and to meet the project's objectives. Teamwork is a critical factor for project success, and developing effective project teams is one of the primary responsibilities of the project manager. Project managers should create an environment that facilitates teamwork and continually motivates the team by providing challenges and opportunities, providing timely feedback and support as needed, and recognizing and rewarding good performance. High team performance can be achieved by employing these behaviors: Using open and effective communication, Creating team-building opportunities, Developing trust among team members, Managing conflicts in a constructive manner, Encouraging collaborative problem solving, and Encouraging collaborative decision making. Project managers operate in a global environment and work on projects characterized by cultural diversity. Team members often have diverse industry experience, communicate in multiple languages, and sometimes work with a “team language” or cultural norm that may be different from their native one. The project management team should capitalize on cultural differences, focus on developing and sustaining the project team throughout the project life cycle, and promote working together interdependently in a climate of mutual trust. Developing the project team improves the people skills, technical competencies, and overall team environment and project performance. It requires clear, timely, effective, and efficient communication between team members throughout the life of the project. Objectives of developing a project team include but are not limited to: Improving the knowledge and skills of team members to increase their ability to complete project deliverables, while lowering costs, reducing schedules, and improving quality; Improving feelings of trust and agreement among team members to raise morale, lower conflict, and increase teamwork; Creating a dynamic, cohesive, and collaborative team culture to: (1) improve individual and team productivity, team spirit, and cooperation; and (2) allow cross-training and mentoring between team members to share knowledge and expertise; and
  • 386.
    Empowering the teamto participate in decision making and take ownership of the provided solutions to improve team productivity for more effective and efficient results. One of the models used to describe team development is the Tuckman ladder [19, 20], which includes five stages of development that teams may go through. Although it is common for these stages to occur in order, it is not uncommon for a team to get stuck in a particular stage or regress to an earlier stage. Projects with team members who worked together in the past might skip a stage. Forming. This phase is where the team members meet and learn about the project and their formal roles and responsibilities. Team members tend to be independent and not as open in this phase. Storming. During this phase, the team begins to address the project work, technical decisions, and the project management approach. If team members are not collaborative or open to differing ideas and perspectives, the environment can become counterproductive. Norming. In this phase, team members begin to work together and adjust their work habits and behaviors to support the team. The team members learn to trust each other. Performing. Teams that reach the performing stage function as a well- organized unit. They are interdependent and work through issues smoothly and effectively. Adjourning. In this phase, the team completes the work and moves on from the project. This typically occurs when staff is released from the project as deliverables are completed or as part of the Close Project or Phase process. The duration of a particular stage depends upon team dynamics, team size, and team leadership. Project managers should have a good understanding of team dynamics in order to move their team members through all stages in an effective manner. 9.4.1 DEVELOP TEAM: INPUTS 9.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include
  • 387.
    but are notlimited to the resource management plan. Described in Section 9.1.3.1, the resource management plan provides guidance on providing project team member rewards, feedback, additional training, and disciplinary actions as a result of team performance assessments and other forms of project team management. The resource management plan may include also the team performance assessment criteria. 9.4.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to developing the team can be applied to later phases in the project to improve team performance. Project schedule. Described in Section 6.5.3.2. The project schedule defines how and when to provide training to the project team and develop the competencies required at different phases. It identifies the need for team development strategies based on variations, if any, during the project execution. Project team assignments. Described in Section 9.3.3.1. Project team assignments identify the team and member roles and responsibilities. Resource calendars. Described in Section 9.2.1.2. Resource calendars identify times when the project team members can participate in team development activities. It also helps illustrate team availability during the entire project. Team charter. Described in Section 9.1.3.2. The team charter is where the team operating guidelines are documented. The team values and operating guidelines provide the structure that describes how the team will operate together. 9.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Develop Team process include but are not limited to: Human resource management policies regarding hiring and termination, employee performance reviews, employee development and training records, and recognition and rewards;
  • 388.
    Team member skills,competencies, and specialized knowledge; and Geographic distribution of team members. 9.4.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Develop Team process include but are not limited to historical information and the lessons learned repository. 9.4.2 DEVELOP TEAM: TOOLS AND TECHNIQUES 9.4.2.1 COLOCATION Colocation involves placing many or all of the most active project team members in the same physical location to enhance their ability to perform as a team. Colocation can be temporary, such as at strategically important times during the project, or can continue for the entire project. Colocation strategies can include a team meeting room, common places to post schedules, and other conveniences that enhance communication and a sense of community. 9.4.2.2 VIRTUAL TEAMS The use of virtual teams can bring benefits such as the use of more skilled resources, reduced costs, less travel and relocation expenses, and the proximity of team members to suppliers, customers, or other key stakeholders. Virtual teams can use technology to create an online team environment where the team can store files, use conversations threads to discuss issues, and keep a team calendar. 9.4.2.3 COMMUNICATION TECHNOLOGY Described in Section 10.1.2.3. Communication technology is important in addressing the team development issues in colocated and virtual teams. It helps build a harmonious environment for the colocated team and a better understanding for the virtual team, especially those working in different time zones. Examples of communication technology that may be used are: Shared portal. A shared repository for information sharing (e.g., website, collaboration software or intranet) is effective for virtual
  • 389.
    project teams. Video conferencing.Video conferencing is an important technique for effective communication with virtual teams. Audio conferencing. Communication within a team using audio conferencing is another technique to build rapport and confidence within virtual teams. Email/chat. Regular communications using email and chat is also an effective technique. 9.4.2.4 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Conflict management. Described in Section 9.5.2.1. The project manager needs to resolve conflicts in a timely manner and in a constructive way in order to achieve a high-performing team. Influencing. Described in Section 9.5.2.1. An influencing skill used in this process is gathering relevant and critical information to address important issues and reach agreements while maintaining mutual trust. Motivation. Motivation is providing a reason for someone to act. Teams are motivated by empowering them to participate in decision making and encouraging them to work independently. Negotiation. Described in Section 12.2.2.5. Negotiation among team members is used to reach consensus on project needs. Negotiation can build trust and harmony among the team members. Team building. Team building is conducting activities that enhance the team's social relations and build a collaborative and cooperative working environment. Team building activities can vary from a 5- minute agenda item in a status review meeting to an offsite, professionally facilitated event designed to improve interpersonal relationships. The objective of team-building activities is to help individual team members work together effectively. Team-building strategies are particularly valuable when team members operate from remote locations without the benefit of face-to-face contact. Informal communication and activities can help in building trust and establishing good working relationships. While team building is
  • 390.
    essential during theinitial stages of a project, it should be a continuous process. Changes in a project environment are inevitable, and to manage them effectively, a continuous or renewed team-building effort may be applied. The project manager should continually monitor team functionality and performance to determine if any actions are needed to prevent or correct various team problems. 9.4.2.5 RECOGNITION AND REWARDS Part of the team development process involves recognizing and rewarding desirable behavior. The original plan for rewarding people is developed during the Plan Resource Management process. Rewards will be effective only if they satisfy a need that is valued by that individual. Reward decisions are made, formally or informally, during the process of managing the project team. Cultural differences should be considered when determining recognition and rewards. People are motivated when they feel they are valued in the organization and this value is demonstrated by the rewards given to them. Generally, money is viewed as a tangible aspect of any reward system, but intangible rewards could be equally or even more effective. Most project team members are motivated by an opportunity to grow, accomplish, be appreciated, and apply their professional skills to meet new challenges. A good strategy for project managers is to give the team recognition throughout the life cycle of the project rather than waiting until the project is completed. 9.4.2.6 TRAINING Training includes all activities designed to enhance the competencies of the project team members. Training can be formal or informal. Examples of training methods include classroom, online, computer-based, on-the-job training from another project team member, mentoring, and coaching. If project team members lack the necessary management or technical skills, such skills can be developed as part of the project work. Scheduled training takes place as stated in the resource management plan. Unplanned training takes place as a result of observation, conversation, and project performance appraisals conducted during management of the project team. Training costs could be included in the project budget or supported by the performing organization if the added skills may be useful for future projects. It may be performed by in-house or by external trainers.
  • 391.
    9.4.2.7 INDIVIDUAL ANDTEAM ASSESSMENTS Individual and team assessment tools give the project manager and the project team insight into areas of strengths and weaknesses. These tools help project managers assess team members’ preferences, aspirations, how they process and organize information, how they make decisions, and how they interact with people. Various tools are available such as attitudinal surveys, specific assessments, structured interviews, ability tests, and focus groups. These tools can provide improved understanding, trust, commitment, and communications among team members and facilitate more productive teams throughout the project. 9.4.2.8 MEETINGS Meetings are used to discuss and address pertinent topics for developing the team. Attendees include the project manager and the project team. Types of meetings include but are not limited to project orientation meetings, team- building meetings, and team development meetings. 9.4.3 DEVELOP TEAM: OUTPUTS 9.4.3.1 TEAM PERFORMANCE ASSESSMENTS As project team development efforts such as training, team building, and colocation are implemented, the project management team makes formal or informal assessments of the project team's effectiveness. Effective team development strategies and activities are expected to increase the team's performance, which increases the likelihood of meeting project objectives. The evaluation of a team's effectiveness may include indicators such as: Improvements in skills that allow individuals to perform assignments more effectively, Improvements in competencies that help team members perform better as a team, Reduced staff turnover rate, and Increased team cohesiveness where team members share information and experiences openly and help each other to improve the overall project performance.
  • 392.
    As a resultof conducting an evaluation of the team's overall performance, the project management team can identify the specific training, coaching, mentoring, assistance, or changes required to improve the team's performance. This should also include identifying the appropriate or required resources necessary to achieve and implement the improvements identified in the assessment. 9.4.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. If change requests occur as a result of carrying out the Develop Team process or if recommended corrective or preventive actions impact any of the components of the project management plan or project documents, the project manager needs to submit a change request and follow the Perform Integrated Change Control process as defined in Section 4.6. 9.4.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to the resource management plan, as described in Section 9.1.3.1. 9.4.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well for the development of the team. Project schedule. Described in Section 6.5.3.2. Activities to develop the project team may result in changes to the project schedule. Project team assignments. Described in Section 9.3.3.1. When team development results in changes to agreed-upon assignments, these changes are recorded in the project team assignments documentation. Resource calendars. Described in Section 9.2.1.2. Resource calendars are updated to reflect the availability of resources for the project. Team charter. Described in Section 9.1.3.2. The team charter may be updated to reflect changes to agreed-upon team operating guidelines
  • 393.
    that result fromteam development. 9.4.3.5 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES Enterprise environmental factors that are updated as a result of the Develop Project Team process include but are not limited to: Employee development plan records, and Skill assessments. 9.4.3.6 ORGANIZATIONAL PROCESS ASSETS UPDATES Organizational process assets that are updated as a result of the Develop Team process include but are not limited to: Training requirements, and Personnel assessment. 9.5 MANAGE TEAM Manage Team is the process of tracking team member performance, providing feedback, resolving issues, and managing team changes to optimize project performance. The key benefit of this process is that it influences team behavior, manages conflict, and resolves issues. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 9-12. Figure 9-13 depicts the data flow diagram for the process.
  • 394.
    Managing the projectteam requires a variety of management and leadership
  • 395.
    skills for fosteringteamwork and integrating the efforts of team members to create high-performance teams. Team management involves a combination of skills with special emphasis on communication, conflict management, negotiation, and leadership. Project managers should provide challenging assignments to team members and provide recognition for high performance. The project manager needs to be sensitive to both the willingness and the ability of team members to perform their work and adjust their management and leadership styles accordingly. Team members with low-skill abilities will require more intensive oversight than those who have demonstrated ability and experience. 9.5.1 MANAGE TEAM: INPUTS 9.5.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the resource management plan. Described in Section 9.1.3.1, the resource management plan provides guidance on how project team resources should be managed and eventually released. 9.5.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Issue log. Described in Section 4.3.3.3. Issues arise in the course of managing the project team. An issue log can be used to document and monitor who is responsible for resolving specific issues by a target date. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve the efficiency and effectiveness of managing the team. Project team assignments. Described in Section 9.3.3.1. Project team assignments identify the team member roles and responsibilities. Team charter. Described in Section 9.1.3.2. The team charter provides guidance for how the team will make decisions, conduct meetings, and resolve conflict.
  • 396.
    9.5.1.3 WORK PERFORMANCEREPORTS Described in Section 4.5.3.1. Work performance reports are the physical or electronic representation of work performance information intended to generate decisions, actions, or awareness. Performance reports that can help with project team management include results from schedule control, cost control, quality control, and scope validation. The information from performance reports and related forecasts assists in determining future team resource requirements, recognition and rewards, and updates to the resource management plan. 9.5.1.4 TEAM PERFORMANCE ASSESSMENTS Described in Section 9.4.3.1. The project management team makes ongoing formal or informal assessments of the project team's performance. By continually assessing the project team's performance, actions can be taken to resolve issues, modify communication, address conflict, and improve team interaction. 9.5.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Manage Team process include but are not limited to human resource management policies. 9.5.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Manage Team process include but are not limited to: Certificates of appreciation, Corporate apparel, and Other organizational perquisites. 9.5.2 MANAGE TEAM: TOOLS AND TECHNIQUES 9.5.2.1 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Conflict management. Conflict is inevitable in a project environment.
  • 397.
    Sources of conflictinclude scarce resources, scheduling priorities, and personal work styles. Team ground rules, group norms, and solid project management practices, like communication planning and role definition, reduce the amount of conflict. Successful conflict management results in greater productivity and positive working relationships. When managed properly, differences of opinion can lead to increased creativity and better decision making. If the differences become a negative factor, project team members are initially responsible for their resolution. If conflict escalates, the project manager should help facilitate a satisfactory resolution. Conflict should be addressed early and usually in private, using a direct, collaborative approach. If disruptive conflict continues, formal procedures may be used, including disciplinary actions. The success of project managers in managing their project teams often depends on their ability to resolve conflict. Different project managers may use different conflict resolution methods. Factors that influence conflict resolution methods include: Importance and intensity of the conflict, Time pressure for resolving the conflict, Relative power of the people involved in the conflict, Importance of maintaining a good relationship, and Motivation to resolve conflict on a long-term or short-term basis. There are five general techniques for resolving conflict. Each technique has its place and use: Withdraw/avoid. Retreating from an actual or potential conflict situation; postponing the issue to be better prepared or to be resolved by others. Smooth/accommodate. Emphasizing areas of agreement rather than areas of difference; conceding one's position to the needs of others to maintain harmony and relationships. Compromise/reconcile. Searching for solutions that bring some degree of satisfaction to all parties in order to temporarily or partially resolve the conflict. This approach occasionally results in a lose-lose situation.
  • 398.
    Force/direct. Pushing one'sviewpoint at the expense of others; offering only win-lose solutions, usually enforced through a power position to resolve an emergency. This approach often results to a win-lose situation. Collaborate/problem solve. Incorporating multiple viewpoints and insights from differing perspectives; requires a cooperative attitude and open dialogue that typically leads to consensus and commitment. This approach can result in a win-win situation. Decision making. Decision making, in this context, involves the ability to negotiate and influence the organization and the project management team, rather than the set of tools described in the decision making tool set. Some guidelines for decision making include: Focus on goals to be served, Follow a decision-making process, Study the environmental factors, Analyze available information, Stimulate team creativity, and Account for risk. Emotional intelligence. Emotional intelligence is the ability to identify, assess, and manage the personal emotions of oneself and other people, as well as the collective emotions of groups of people. The team can use emotional intelligence to reduce tension and increase cooperation by identifying, assessing, and controlling the sentiments of project team members, anticipating their actions, acknowledging their concerns, and following up on their issues. Influencing. Because project managers often have little or no direct authority over team members in a matrix environment, their ability to influence stakeholders on a timely basis is critical to project success. Key influencing skills include: Ability to be persuasive; Clearly articulating points and positions; High levels of active and effective listening skills; Awareness of, and consideration for, the various perspectives in any
  • 399.
    situation; and Gathering relevantinformation to address issues and reach agreements while maintaining mutual trust. Leadership. Successful projects require leaders with strong leadership skills. Leadership is the ability to lead a team and inspire them to do their jobs well. It encompasses a wide range of skills, abilities and actions. Leadership is important through all phases of the project life cycle. There are multiple leadership theories defining leadership styles that should be used as needed for each situation or team. It is especially important to communicate the vision and inspire the project team to achieve high performance. 9.5.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems can include resource management or scheduling software that can be used for managing and coordinating team members across project activities. 9.5.3 MANAGE TEAM: OUTPUTS 9.5.3.1 CHANGE REQUESTS Described in Section 4.3.3.4. When change requests occur as a result of carrying out the Manage Team process or when recommended corrective or preventive actions impact any of the components of the project management plan or project documents, the project manager needs to submit a change request. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). For example, staffing changes, whether made by choice or by uncontrollable events, can disrupt the project team. This disruption can cause the schedule to slip or the budget to be exceeded. Staffing changes include moving people to different assignments, outsourcing some of the work, or replacing team members who leave. 9.5.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components of the project
  • 400.
    management plan thatmay require a change request for the project management plan include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan is updated to reflect actual experience in managing the project team. Schedule baseline. Described in Section 6.5.3.1. Changes to the project schedule may be required to reflect the way the team is performing. Cost baseline. Described in Section 7.3.3.1. Changes to the project cost baseline may be required to reflect the way the team is performing. 9.5.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. New issues raised as a result of this process are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well for the managing the team. Project team assignments. Described in Section 9.3.3.1. If changes to the team are required, those changes are recorded in the project team assignments documentation. 9.5.3.4 ENTERPRISE ENVIRONMENTAL FACTORS UPDATES Enterprise environmental factors that are updated as a result of the Manage Team process include but are not limited to: Input to organizational performance appraisals, and Personnel skill. 9.6 CONTROL RESOURCES Control Resources is the process of ensuring that the physical resources assigned and allocated to the project are available as planned, as well as
  • 401.
    monitoring the plannedversus actual utilization of resources and taking corrective action as necessary. The key benefit of this process is ensuring that the assigned resources are available to the project at the right time and in the right place and are released when no longer needed. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 9-14. Figure 9-15 depicts the data flow diagram for the process.
  • 402.
    The Control Resourcesprocess should be performed continuously in all project phases and throughout the project life cycle. The resources needed for the project should be assigned and released at the right time, right place, and right amount for the project to continue without delays. The Control Resources process is concerned with physical resources such as equipment, materials, facilities, and infrastructure. Team members are addressed in the Manage Team process. The Control Resources techniques discussed here are those used most frequently on projects. There are many others that may be useful on certain projects or in some application areas. Updating resource allocation requires knowing what actual resources have been used to date and what is still needed. This is done mainly by reviewing the performance usage to date. Control Resources is concerned with:
  • 403.
    Monitoring resource expenditures, Identifyingand dealing with resource shortage/surplus in a timely manner, Ensuring that resources are used and released according to the plan and project needs, Informing appropriate stakeholders if any issues arise with relevant resources, Influencing the factors that can create resources utilization change, and Managing the actual changes as they occur. Any changes needed to the schedule or cost baselines can be approved only through the Perform Integrated Change Control process (Section 4.6). 9.6.1 CONTROL RESOURCES: INPUTS 9.6.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the resource management plan. Described in Section 9.1.3.1, the resource management plan provides guidance on how physical resources should be used, controlled, and eventually released. 9.6.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Issue log. Described in Section 4.3.3.3. The issue log is used to identify issues such as lack of resources, delays in raw material supplies, or low grades of raw material. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve physical resource control. Physical resource assignments. Described in Section 9.3.3.1. The physical resource assignments describe the expected resource utilization along with details such as type, amount, location, and whether the resource is internal to the organization or outsourced.
  • 404.
    Project schedule. Describedin Section 6.5.3.2. The project schedule shows the resources that are needed, when they are needed, and the location where they are needed. Resource breakdown structure. Described in Section 9.2.3.3. The resource breakdown structure provides a reference in case any resource needs to be replaced or reacquired during the course of the project. Resource requirements. Described in Section 9.2.3.1. Resource requirements identify the needed material, equipment, supplies, and other resources. Risk register. Described in Section 11.2.3.1. The risk register identifies individual risks that can impact equipment, materials, or supplies. 9.6.1.3 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on project status such as the number and type of resources that have been used. 9.6.1.4 AGREEMENTS Described in Section 12.2.3.2. Agreements made within the context of the project are the basis for all resources external to the organization and should define procedures when new, unplanned resources are needed or when issues arise with the current resources. 9.6.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Control Resources process include but are not limited to: Policies regarding resource control and assignment, Escalation procedures for handling issues within the performing organization, and Lessons learned repository from previous similar projects. 9.6.2 CONTROL RESOURCES: TOOLS AND TECHNIQUES 9.6.2.1 DATA ANALYSIS
  • 405.
    Data analysis techniquesthat can be used in this process include but are not limited to: Alternatives analysis. Described in Section 9.2.2.5. Alternatives can be analyzed to select the best resolution for correcting variances in resource utilization. Alternatives such as paying additional for overtime or additional team resources can be weighed against a late delivery or phased deliveries. Cost-benefit analysis. Described in Section 8.1.2.3. This analysis helps to determine the best corrective action in terms of cost in case of project deviations. Performance reviews. Performance reviews measure, compare, and analyze planned resource utilization to actual resource utilization. Cost and schedule work performance information can also be analyzed to help pinpoint issues that can influence resource utilization. Trend analysis. Described in Section 4.5.2.2. As the project progresses, the project team may use trend analysis, based on current performance information, to determine the resources needed at upcoming stages of the project. Trend analysis examines project performance over time and can be used to determine whether performance is improving or deteriorating. 9.6.2.2 PROBLEM SOLVING Described in Section 8.2.2.7. Problem solving may use a set of tools that helps the project manager to solve problems that arise during the control resource process. The problem can come from inside the organization (machines or infrastructure used by another department in the organization and not released in time, materials that have been damaged because of unsuitable storage conditions, etc.) or from outside the organization (major supplier that has gone bankrupt or bad weather that has damaged resources). The project manager should use methodical steps to deal with problem solving, which can include: Identify the problem. Specify the problem. Define the problem. Break it into smaller, manageable problems. Investigate. Collect data. Analyze. Find the root cause of the problem. Solve. Choose the suitable solution from a variety of available ones.
  • 406.
    Check the solution.Determine if the problem has been fixed. 9.6.2.3 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills, sometimes known as “soft skills,” are personal competencies. The interpersonal and team skills used in this process include: Negotiation. Described in Section 12.2.2.5. The project manager may need to negotiate for additional physical resources, changes in physical resources, or costs associated with the resources. Influencing. Described in Section 9.5.2.1. Influencing can help the project manager solve problems and obtain the resources needed in a timely manner. 9.6.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems can include resource management or scheduling software that can be used to monitor the resource utilization which helps ensure that the right resources are working on the right activities at the right time and place. 9.6.3 CONTROL RESOURCES: OUTPUTS 9.6.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how the project work is progressing by comparing resource requirements and resource allocation to resource utilization across the project activities. This comparison can show gaps in resource availability that need to be addressed. 9.6.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. When change requests occur as a result of carrying out the Control Resources process or when recommended, corrective, or preventive actions impact any of the components of the project management plan or project documents, the project manager needs to submit a change request. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6).
  • 407.
    9.6.3.3 PROJECT MANAGEMENTPLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan is updated to reflect actual experience in managing project resources. Schedule baseline. Described in Section 6.5.3.1. Changes to the project schedule may be required to reflect the way project resources are being managed. Cost baseline. Described in Section 7.3.3.1. Changes to the project cost baseline may be required to reflect the way project resources are being managed. 9.6.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of performing this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log may be updated with new assumptions regarding equipment, materials, supplies, and other physical resources. Issue log. Described in Section 4.3.3.3. New issues raised as a result of this process are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were effective in managing resource logistics, scrap, utilization variances, and corrective actions that were used to respond to resource variances. Physical resource assignments. Described in Section 9.3.3.1. Physical resource assignments are dynamic and subject to change due to availability, the project, organization, environment, or other factors. Resource breakdown structure. Described in Section 9.2.3.3. Changes to the resource breakdown structure may be required to reflect the way project resources are being used. Risk register. Described in Section 11.2.3.1. The risk register is updated with any new risks associated with resource availability,
  • 408.
    utilization, or otherphysical resource risks.
  • 409.
    10 PROJECT COMMUNICATIONS MANAGEMENT ProjectCommunications Management includes the processes necessary to ensure that the information needs of the project and its stakeholders are met through development of artifacts and implementation of activities designed to achieve effective information exchange. Project Communications Management consists of two parts. The first part is developing a strategy to ensure communication is effective for stakeholders. The second part is carrying out the activities necessary to implement the communication strategy. The Project Communications Management processes are: 10.1 Plan Communications Management—The process of developing an appropriate approach and plan for project communication activities based on the information needs of each stakeholder or group, available organizational assets, and the needs of the project. 10.2 Manage Communications—The process of ensuring timely and appropriate collection, creation, distribution, storage, retrieval, management, monitoring, and the ultimate disposition of project information. 10.3 Monitor Communications—The process of ensuring the information needs of the project and its stakeholders are met. Figure 10-1 provides an overview of the Project Communications Management processes. The Project Communications Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 410.
    KEY CONCEPTS FORPROJECT COMMUNICATIONS MANAGEMENT Communication is the exchange of information, intended or involuntary. The information exchanged can be in the form of ideas, instructions, or emotions. The mechanisms by which information is exchanged can be in: Written form. Either physical or electronic. Spoken. Either face-to-face or remote. Formal or informal (as in formal papers or social media). Through gestures. Tone of voice and facial expressions. Through media. Pictures, actions, or even just the choice of words. Choice of words. There is often more than one word to express an idea; there can be subtle differences in the meaning of each of these words and phrases. Communications describe the possible means by which the information can be sent or received, either through communication activities, such as meetings and presentations, or artifacts, such as emails, social media, project reports, or
  • 411.
    project documentation. Project managersspend most of their time communicating with team members and other project stakeholders, both internal (at all organizational levels) and external to the organization. Effective communication builds a bridge between diverse stakeholders who may have different cultural and organizational backgrounds as well as different levels of expertise, perspectives, and interests. Communication activities have many dimensions, including but not limited to: Internal. Focus on stakeholders within the project and within the organization. External. Focus on external stakeholders such as customers, vendors, other projects, organizations, government, the public, and environmental advocates. Formal. Reports, formal meetings (both regular and ad hoc), meeting agendas and minutes, stakeholder briefings, and presentations. Informal. General communications activities using emails, social media, websites, and informal ad hoc discussions. Hierarchical focus. The position of the stakeholder or group with respect to the project team will affect the format and content of the message, in the following ways: Upward. Senior management stakeholders. Downward. The team and others who will contribute to the work of the project. Horizontal. Peers of the project manager or team. Official. Annual reports; reports to regulators or government bodies. Unofficial. Communications that focus on establishing and maintaining the profile and recognition of the project and building strong relationships between the project team and its stakeholders using flexible and often informal means. Written and oral. Verbal (words and voice inflections) and nonverbal (body language and actions), social media and websites, media releases. Communication develops the relationships necessary for successful project and program outcomes. Communication activities and artifacts to support
  • 412.
    communication vary widely,ranging from emails and informal conversations to formal meetings and regular project reports. The act of sending and receiving information takes place consciously or unconsciously through words, facial expressions, gestures and other actions. In the context of successfully managing project relationships with stakeholders, communication includes developing strategies and plans for suitable communications artifacts and activities with the stakeholder community and the application of skills to enhance the effectiveness of the planned and other ad hoc communications. There are two parts to successful communication. The first part involves developing an appropriate communication strategy based on both the needs of the project and the project's stakeholders. From that strategy, a communications management plan is developed to ensure that the appropriate messages are communicated to stakeholders in various formats and various means as defined by the communication strategy. These messages constitute the project's communications—the second part of successful communication. Project communications are the products of the planning process, addressed by the communications management plan that defines the collection, creation, dissemination, storage, retrieval, management, tracking, and disposition of these communications artifacts. Finally, the communication strategy and communications management plan will form the foundation to monitor the effect of the communication. The project's communications are supported by efforts to prevent misunderstandings and miscommunication and by careful selection of the methods, messengers, and messages developed from the planning process. Misunderstandings can be reduced but not eliminated through using the 5Cs of written communications in composing a traditional (non-social media) written or spoken message: Correct grammar and spelling. Poor use of grammar or inaccurate spelling can be distracting and can also introduce distortions in the message, diminishing credibility. Concise expression and elimination of excess words. A concise, well- crafted message reduces the opportunities for misunderstanding the intent of the message. Clear purpose and expression directed to the needs of the reader. Ensure that the needs and interests of the audience are factored into the message.
  • 413.
    Coherent logical flowof ideas. A coherent logical flow of ideas and using “markers” such as introduction and summaries of the ideas throughout the writing. Controlling flow of words and ideas. Controlling the flow of words and ideas may involve graphics or just summaries. The 5Cs of written communications are supported by communication skills, such as: Listening actively. Staying engaged with the speaker and summarizing conversations to ensure effective information exchange. Awareness of cultural and personal differences. Developing the team's awareness of cultural and personal differences to reduce misunderstandings and enhance communication capability. Identifying, setting, and managing stakeholder expectations. Negotiating with stakeholders reduces the existence of conflicting expectations among the stakeholder community. Enhancement of skills. Enhancing the skills of all team members in the following activities: Persuading a person, a team, or an organization to perform an action; Motivating people and providing encouragement or reassurance; Coaching to improve performance and achieve desired results; Negotiating to achieve mutually acceptable agreements between parties and reduce approval or decision delays; and Resolving conflict to prevent disruptive impacts. The fundamental attributes of effective communication activities and developing effective communication artifacts are: Clarity on the purpose of the communication—defining its purpose; Understanding as much as possible about the receiver of the communications, meeting needs, and preferences; and Monitoring and measuring the effectiveness of the communications. TRENDS AND EMERGING PRACTICES IN PROJECT COMMUNICATIONS MANAGEMENT
  • 414.
    Along with afocus on stakeholders and recognition of the value to projects and organizations of effective stakeholder engagement comes the recognition that developing and implementing appropriate communication strategies is vital to maintaining effective relationships with stakeholders. Trends and emerging practices for Project Communications Management include but are not limited to: Inclusion of stakeholders in project reviews. The stakeholder community of each project includes individuals, groups, and organizations that the project team has identified as essential to the successful delivery of project objectives and organizational outcomes. An effective communication strategy requires regular and timely reviews of the stakeholder community and updates to manage changes in its membership and attitudes. Inclusion of stakeholders in project meetings. Project meetings should include stakeholders from outside the project and even the organization, where appropriate. Practices inherent in the agile approaches can be applied to all types of projects. Practices often include short, daily standup meetings, where the achievements and issues of the previous day, and plans for the current day's work, are discussed with the project team and key stakeholders. Increased use of social computing. Social computing in the form of infrastructure, social media services, and personal devices has changed how organizations and their people communicate and do business. Social computing incorporates different approaches to collaboration supported by public IT infrastructure. Social networking refers to how users build networks of relationships to explore their interests and activities with others. Social media tools can not only support information exchange, but also build relationships accompanied by deeper levels of trust and community. Multifaceted approaches to communication. The standard communication strategy for project stakeholder communications embraces and selects from all technologies and respects cultural, practical, and personal preferences for language, media, content, and delivery. When appropriate, social media and other advanced computing technologies may be included. Multifaceted approaches such as these are more effective for communicating to stakeholders from different generations and cultures.
  • 415.
    TAILORING CONSIDERATIONS Because eachproject is unique, the project team will need to tailor the way that Project Communications Management processes are applied. Considerations for tailoring include but are not limited to: Stakeholders. Are the stakeholders internal or external to the organization, or both? Physical location. What is the physical location of team members? Is the team colocated? Is the team in the same geographical area? Is the team distributed across multiple time zones? Communications technology. What technology is available to develop, record, transmit, retrieve, track, and store communication artifacts? What technologies are most appropriate and cost effective for communicating to stakeholders? Language. Language is a main factor to consider in communication activities. Is one language used? Or are many languages used? Have allowances been made to adjust to the complexity of team members from diverse language groups? Knowledge management. Does the organization have a formal knowledge management repository? Is the repository used? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS Project environments subject to various elements of ambiguity and change have an inherent need to communicate evolving and emerging details more frequently and quickly. This motivates streamlining team member access to information, frequent team checkpoints, and colocating team members as much as possible. In addition, posting project artifacts in a transparent fashion, and holding regular stakeholder reviews are intended to promote communication with management and stakeholders. 10.1 PLAN COMMUNICATIONS MANAGEMENT Plan Communications Management is the process of developing an appropriate approach and plan for project communications activities based on the information needs of each stakeholder or group, available organizational
  • 416.
    assets, and theneeds of the project. The key benefit of this process is a documented approach to effectively and efficiently engage stakeholders by presenting relevant information in a timely manner. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of the process are depicted in Figure 10-2. Figure 10-3 depicts the data flow diagram for the process.
  • 417.
    An effective communicationsmanagement plan that recognizes the diverse information needs of the project's stakeholders is developed early in the project life cycle. It should be reviewed regularly and modified when necessary, when the stakeholder community changes or at the start of each new project phase. On most projects, communications planning is performed very early, during stakeholder identification and project management plan development. While all projects share the need to communicate project information, the information needs and methods of distribution may vary widely. In addition, the methods of storage, retrieval, and ultimate disposition of the project information need to be considered and documented during this process. The results of the Plan Communications Management process should be reviewed regularly throughout the project and revised as needed to ensure continued applicability. 10.1.1 PLAN COMMUNICATIONS MANAGEMENT: INPUTS 10.1.1.1 PROJECT CHARTER
  • 418.
    Described in Section4.1.3.1. The project charter identifies the key stakeholder list. It may also contain information about the roles and responsibilities of the stakeholders. 10.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. Provides guidance on how team resources will be categorized, allocated, managed, and released. Team members and groups may have communication requirements that should be identified in the communications management plan. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan identifies the management strategies required to effectively engage stakeholders. These strategies are often fulfilled via communications. 10.1.1.3 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Requirements documentation. Described in Section 5.2.3.1. Requirements documentation can include project stakeholder communications. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register is used to plan communications activities with stakeholders. 10.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Communications Management process include but are not limited to: Organizational culture, political climate, and governance framework; Personnel administration policies; Stakeholder risk thresholds; Established communication channels, tools, and systems;
  • 419.
    Global, regional, orlocal trends, practices, or habits; and Geographic distribution of facilities and resources. 10.1.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Communications Management process include but are not limited to: Organizational policies and procedures for social media, ethics, and security; Organizational policies and procedures for issue, risk, change, and data management; Organizational communication requirements; Standardized guidelines for development, exchange, storage, and retrieval of information; Historical information and lessons learned repository; and Stakeholder and communications data and information from previous projects. 10.1.2 PLAN COMMUNICATIONS MANAGEMENT: TOOLS AND TECHNIQUES 10.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Politics and power structures in the organization; Environment and culture of the organization and other customer organizations; Organizational change management approach and practices; Industry or type of project deliverables; Organizational communications technologies; Organizational policies and procedures regarding legal requirements of corporate communications;
  • 420.
    Organizational policies andprocedures regarding security; and Stakeholders, including customers or sponsors. 10.1.2.2 COMMUNICATION REQUIREMENTS ANALYSIS Analysis of communication requirements determines the information needs of the project stakeholders. These requirements are defined by combining the type and format of information needed with an analysis of the value of that information. Sources of information typically used to identify and define project communication requirements include but are not limited to: Stakeholder information and communication requirements from within the stakeholder register and stakeholder engagement plan; Number of potential communication channels or paths, including one- to-one, one-to-many, and many-to-many communications; Organizational charts; Project organization and stakeholder responsibility, relationships, and interdependencies; Development approach; Disciplines, departments, and specialties involved in the project; Logistics of how many persons will be involved with the project and at which locations; Internal information needs (e.g., when communicating within organizations); External information needs (e.g., when communicating with the media, public, or contractors); and Legal requirements. 10.1.2.3 COMMUNICATION TECHNOLOGY The methods used to transfer information among project stakeholders may vary significantly. Common methods used for information exchange and collaboration include conversations, meetings, written documents, databases, social media, and websites. Factors that can affect the choice of communication technology include:
  • 421.
    Urgency of theneed for information. The urgency, frequency, and format of the information to be communicated may vary from project to project and also within different phases of a project. Availability and reliability of technology. The technology that is required for distribution of project communications artifacts should be compatible, available, and accessible for all stakeholders throughout the project. Ease of use. The choice of communication technologies should be suitable for project participants and proper training events should be planned, where appropriate. Project environment. Whether the team will meet and operate on a face-to-face basis or in a virtual environment; whether they will be located in one or multiple time zones; whether they will use multiple languages for communication; and finally, whether there are any other project environmental factors, such as various aspects of culture, which may constrain the efficiency of the communication. Sensitivity and confidentiality of the information. Some aspects to consider are: Whether information to be communicated is sensitive or confidential. If so, additional security measures may be required. Social media policies for employees to ensure appropriate behavior, security, and the protection of proprietary information. 10.1.2.4 COMMUNICATION MODELS Communication models can represent the communication process in its most basic linear form (sender and receiver), in a more interactive form that encompasses the additional element of feedback (sender, receiver, and feedback), or in a more complex model that incorporates the human elements of the sender(s) or receiver(s) and attempts to show the complexity of any communication that involves people. Sample basic sender/receiver communication model. This model describes communication as a process and consists of two parties, defined as the sender and receiver. This model is concerned with ensuring that the message is delivered, rather than understood. The sequence of steps in a basic communication model is:
  • 422.
    Encode. The messageis coded into symbols, such as text, sound or some other medium for transmission (sending). Transmit message. The message is sent via a communication channel. The transmission of this message may be compromised by various physical factors such as unfamiliar technology or inadequate infrastructure. Noise and other factors may be present and contribute to loss of information in transmission and/or reception of the message. Decode. The data received is translated by the receiver back into a form useful to the receiver. Sample interactive communication model. This model also describes communication as a process consisting of two parties, the sender and receiver, but recognizes the need to ensure that the message has been understood. In this model, noise includes any interference or barriers that might compromise the understanding of the message, such as the distraction of the receiver, variations in the perceptions of receivers, or lack of appropriate knowledge or interest. The additional steps in an interactive communication model are: Acknowledge. Upon receipt of a message, the receiver may signal (acknowledge) receipt of the message, but this does not necessarily mean agreement with or comprehension of the message—merely that it has been received. Feedback/response. When the received message has been decoded and understood, the receiver encodes thoughts and ideas into a message and then transmits this message to the original sender. If the sender perceives that the feedback matches the original message, the communication has been successful. In communication between people, feedback can be achieved through active listening, described in Section 10.2.2.6. As part of the communication process, the sender is responsible for the transmission of the message, ensuring the information being communicated is clear and complete, and confirming the message is correctly interpreted. The receiver is responsible for ensuring that the information is received in its entirety, interpreted correctly, and acknowledged or responded to appropriately. These components take place in an environment where there will likely be noise and other barriers to effective communication.
  • 423.
    Cross-cultural communication presentschallenges to ensuring that the meaning of the message has been understood. Differences in communication styles can arise from differences in working methods, age, nationality, professional discipline, ethnicity, race, or gender. People from different cultures communicate using different languages (e.g., technical design documents, different styles) and expect different processes and protocols. The communication model shown in Figure 10-4 incorporates the idea that the message itself and how it is transmitted are influenced by the sender's current emotional state, knowledge, background, personality, culture, and biases. Similarly, the receiver's emotional state knowledge, background, personality, culture, and biases will influence how the message is received and interpreted, and will contribute to the barriers or noise. This communication model and its enhancements can assist in developing communication strategies and plans for person-to-person or even small group to small group communications. It is not useful for other communications artifacts such as emails, broadcast messages, or social media. 10.1.2.5 COMMUNICATION METHODS There are several communication methods that are used to share information among project stakeholders. These methods are broadly classified as follows: Interactive communication. Between two or more parties performing a multidirectional exchange of information in real time. It employs
  • 424.
    communications artifacts suchas meetings, phone calls, instant messaging, some forms of social media, and videoconferencing. Push communication. Sent or distributed directly to specific recipients who need to receive the information. This ensures that the information is distributed but does not ensure that it actually reached or was understood by the intended audience. Push communications artifacts include letters, memos, reports, emails, faxes, voice mails, blogs, and press releases. Pull communication. Used for large complex information sets, or for large audiences, and requires the recipients to access content at their own discretion subject to security procedures. These methods include web portals, intranet sites, e-learning, lessons learned databases, or knowledge repositories. Different approaches should be applied to meet the needs of the major forms of communication defined in the communications management plan: Interpersonal communication. Information is exchanged between individuals, typically face-to-face. Small group communication. Occurs within groups of around three to six people. Public communication. A single speaker addressing a group of people. Mass communication. There is a minimal connection between the person or group sending the message and the large, sometimes anonymous groups for whom the information is intended. Networks and social computing communication. Supports emerging communication trends of many-to-many supported by social computing technology and media. Possible communications artifacts and methods include but are not limited to: Notice boards, Newsletters/in-house magazines/e-magazines, Letters to staff/volunteers, Press releases, Annual reports, Emails and intranets,
  • 425.
    Web portals andother information repositories (for pull communication) Phone conversations, Presentations, Team briefings/group meetings, Focus groups, Face-to-face formal or informal meetings between various stakeholders, Consultation groups or staff forums, and Social computing technology and media. 10.1.2.6 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Communication styles assessment. A technique used to assess communication styles and identify the preferred communication method, format, and content for planned communication activities. Often used with unsupportive stakeholders, this assessment may follow a stakeholder engagement assessment (described in Section 13.2.2.5) to identify gaps in stakeholder engagement that require additional tailored communication activities and artifacts. Political awareness. Political awareness helps the project manager to plan communications based on the project environment as well as the organization's political environment. Political awareness concerns the recognition of power relationships, both formal and informal, and also the willingness to operate within these structures. An understanding of the strategies of the organization, knowing who wields power and influence in this arena, and developing an ability to communicate with these stakeholders are all aspects of political awareness. Cultural awareness. Cultural awareness is an understanding of the differences between individuals, groups, and organizations and adapting the project's communication strategy in the context of these differences. This awareness and any consequent actions minimize misunderstandings and miscommunication that may result from
  • 426.
    cultural differences withinthe project's stakeholder community. Cultural awareness and cultural sensitivity help the project manager to plan communications based on the cultural differences and requirements of stakeholders and team members. 10.1.2.7 DATA REPRESENTATION A data representation technique that can be used for this process includes but is not limited to a stakeholder engagement assessment matrix. Described in Section 13.2.2.5. The stakeholder engagement assessment matrix, shown in Figure 13-6, displays gaps between current and desired engagement levels of individual stakeholders, it can be further analyzed in this process to identify additional communication requirements (beyond the regular reports) as a method to close any engagement level gaps. 10.1.2.8 MEETINGS Project meetings can include virtual (e-meetings) or face-to-face meetings, and can be supported with document collaboration technologies, including email messages and project websites. The Plan Communications Management process requires discussion with the project team to determine the most appropriate way to update and communicate project information, and to respond to requests from various stakeholders for information. 10.1.3 PLAN COMMUNICATIONS MANAGEMENT: OUTPUTS 10.1.3.1 COMMUNICATIONS MANAGEMENT PLAN The communications management plan is a component of the project management plan that describes how project communications will be planned, structured, implemented, and monitored for effectiveness. The plan contains the following information: Stakeholder communication requirements; Information to be communicated, including language, format, content, and level of detail; Escalation processes; Reason for the distribution of that information;
  • 427.
    Timeframe and frequencyfor the distribution of required information and receipt of acknowledgment or response, if applicable; Person responsible for communicating the information; Person responsible for authorizing release of confidential information; Person or groups who will receive the information, including information about their needs, requirements, and expectations; Methods or technologies used to convey the information, such as memos, email, press releases, or social media; Resources allocated for communication activities, including time and budget; Method for updating and refining the communications management plan as the project progresses and develops, such as when the stakeholder community changes as the project moves through different phases; Glossary of common terminology; Flow charts of the information flow in the project, workflows with possible sequence of authorization, list of reports, meeting plans, etc.; and Constraints derived from specific legislation or regulation, technology, organizational policies, etc. The communications management plan can include guidelines and templates for project status meetings, project team meetings, e-meetings, and email messages. The use of a project website and project management software can be included if these are to be used in the project. 10.1.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to the stakeholder engagement plan, which is described in Section 13.2.3.1. The stakeholder engagement plan is updated to reflect any processes, procedures, tools, or techniques that affect the engagement of stakeholders in project decisions and execution.
  • 428.
    10.1.3.3 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Project schedule. Described in Section 6.5.3.2. The project schedule may be updated to reflect communication activities. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register may be updated to reflect communications planned. 10.2 MANAGE COMMUNICATIONS Manage Communications is the process of ensuring timely and appropriate collection, creation, distribution, storage, retrieval, management, monitoring, and the ultimate disposition of project information. The key benefit of this process is that it enables an efficient and effective information flow between the project team and the stakeholders. This process is performed throughout the project. The Manage Communications process identifies all aspects of effective communication, including choice of appropriate technologies, methods, and techniques. In addition, it should allow for flexibility in the communications activities, allowing adjustments in the methods and techniques to accommodate the changing needs of stakeholders and the project. The inputs, tools, techniques, and outputs of this process are depicted in Figure 10-5. Figure 10-6 depicts the data flow diagram of the Manage Communications process.
  • 430.
    This process goesbeyond the distribution of relevant information and seeks to ensure that the information being communicated to project stakeholders has been appropriately generated and formatted, and received by the intended audience. It also provides opportunities for stakeholders to make requests for further information, clarification, and discussion. Techniques and considerations for effective communications management include but are not limited to: Sender-receiver models. Incorporating feedback loops to provide opportunities for interaction/participation and remove barriers to effective communication. Choice of media. Decisions about application of communications artifacts to meet specific project needs, such as when to communicate in writing versus orally, when to prepare an informal memo versus a formal report, and when to use push/pull options and the choice of appropriate technology. Writing style. Appropriate use of active versus passive voice, sentence structure, and word choice. Meeting management. Described in Section 10.2.2.6. Preparing an agenda, inviting essential participants, and ensuring they attend. Dealing with conflicts within the meeting or resulting from inadequate follow-up of minutes and actions, or attendance of the wrong people. Presentations. Awareness of the impact of body language and design of visual aids. Facilitation. Described in Section 4.1.2.3. Building consensus and overcoming obstacles such as difficult group dynamics, and maintaining interest and enthusiasm among group members. Active listening. Described in Section 10.2.2.6. Listening actively involves acknowledging, clarifying and confirming, understanding, and removing barriers that adversely affect comprehension. 10.2.1 MANAGE COMMUNICATIONS: INPUTS 10.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to:
  • 431.
    Resource management plan.Described in Section 9.1.3.1. The resource management plan describes the communications that are needed for management of team or physical resources. Communications management plan. Described in Section 10.1.3.1. The communications management plan describes how project communications will be planned, structured, monitored, and controlled. Stakeholder engagement plan. Described in detail in Section 13.2.3.1. The stakeholder engagement plan describes how stakeholders will be engaged through appropriate communication strategies. 10.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to Change log. Described in Section 4.6.3.3. The change log is used to communicate changes and approved, deferred, and rejected change requests to the impacted stakeholders. Issue log. Described in Section 4.6.3.3. Information about issues is communicated to impacted stakeholders. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to managing communications can be applied to later phases in the project to improve the efficiency and effectiveness of communications and the communication process. Quality report. Described in Section 8.2.3.1. Information in the quality report includes quality issues, project and product improvements, and process improvements. This information is forwarded to those who can take corrective actions in order to achieve the project quality expectations. Risk report. Described in Section 11.2.3.2. The risk report presents information on sources of overall project risk, together with summary information on identified individual project risks. This information is communicated to risk owners and other impacted stakeholders. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register identifies the individuals, groups, or organizations that will need various types of information.
  • 432.
    10.2.1.3 WORK PERFORMANCEREPORTS Described in Section 4.5.3.1. Work performance reports are circulated to the project stakeholders through this process as defined in the communications management plan. Examples of work performance reports include status reports and progress reports. Work performance reports can contain earned value graphs and information, trend lines and forecasts, reserve burndown charts, defect histograms, contract performance information, and risk summaries. They can be presented as dashboards, heat reports, stop light charts, or other representations useful for creating awareness and generating decisions and actions. 10.2.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence this process include but are not limited to: Organizational culture, political climate, and governance framework; Personnel administration policies; Stakeholder risk thresholds; Established communication channels, tools, and systems; Global, regional, or local trends and practices or habits; and Geographic distribution of facilities and resources. 10.2.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence this process include but are not limited to: Corporate policies and procedures for social media, ethics, and security; Corporate policies and procedures for issue, risk, change, and data management; Organizational communication requirements; Standardized guidelines for development, exchange, storage, and retrieval of information; and Historical information from previous projects, including the lessons learned repository.
  • 433.
    10.2.2 MANAGE COMMUNICATIONS:TOOLS AND TECHNIQUES 10.2.2.1 COMMUNICATION TECHNOLOGY Described in Section 10.1.2.3. Factors that influence the technology include whether the team is colocated, the confidentiality of any information that needs to be shared, resources available to the team members, and how the organization's culture influences the way in which meetings and discussions are normally conducted. 10.2.2.2 COMMUNICATION METHODS Described in Section 10.1.2.5. The choice of communication methods should allow flexibility in the event that the membership of the stakeholder community changes or their needs and expectations change. 10.2.2.3 COMMUNICATION SKILLS Communication techniques that can be used for this process include but are not limited to: Communication competence. A combination of tailored communication skills that considers factors such as clarity of purpose in key messages, effective relationships and information sharing, and leadership behaviors. Feedback. Feedback is information about reactions to communications, a deliverable, or a situation. Feedback supports interactive communication between the project manager, team and all other project stakeholders. Examples include coaching, mentoring, and negotiating. Nonverbal. Examples of nonverbal communication include appropriate body language to transmit meaning through gestures, tone of voice, and facial expressions. Mirroring and eye contact are also important techniques. The team members should be aware of how they are expressing themselves both through what they say and what they don't say. Presentations. A presentation is the formal delivery of information and/or documentation. Clear and effective presentations of project
  • 434.
    information to relevantstakeholders can include but are not limited to: Progress reports and information updates to stakeholders; Background information to support decision making; General information about the project and its objectives, for the purposes of raising the profile of the work of the project and the team; and Specific information aimed at increasing understanding and support of the work and objectives of the project. Presentations will be successful when the content and delivery take the following into account: The audience, their expectations, and needs; and The needs and objectives of the project and project team. 10.2.2.4 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems can ensure that stakeholders can easily retrieve the information they need in a timely way. Project information is managed and distributed using a variety of tools, including: Electronic project management tools. Project management software, meeting and virtual office support software, web interfaces, specialized project portals and dashboards, and collaborative work management tools. Electronic communications management. Email, fax, and voice mail; audio, video and web conferencing; and websites and web publishing. Social media management. Websites and web publishing; and blogs and applications, which offer the opportunity to engage with stakeholders and form online communities. 10.2.2.5 PROJECT REPORTING Project reporting is the act of collecting and distributing project information. Project information is distributed to many groups of stakeholders and should be adapted to provide information at an appropriate level, format, and detail for each type of stakeholder. The format may range from a simple communication to more elaborate custom reports and presentations. Information may be prepared
  • 435.
    regularly or onan exception basis. While work performance reports are the output of the Monitor and Control Project Work process, this process develops ad hoc reports, project presentations, blogs, and other types of communication about the project. 10.2.2.6 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Active listening. Techniques of active listening involve acknowledging, clarifying and confirming, understanding, and removing barriers that adversely affect comprehension. Conflict management. Described in Section 9.5.2.1. Cultural awareness. Described in Section 10.1.2.6. Meeting management. Meeting management is taking steps to ensure meetings meet their intended objectives effectively and efficiently. The following steps should be used for meeting planning: Prepare and distribute the agenda stating the objectives of the meeting. Ensure that the meetings start and finish at the published time. Ensure the appropriate participants are invited and attend. Stay on topic. Manage expectations, issues, and conflicts during the meeting. Record all actions and those who have been allocated the responsibility for completing the action. Networking. Networking is interacting with others to exchange information and develop contacts. Networks provide project managers and their teams with access to informal organizations to solve problems, influence actions of their stakeholders, and increase stakeholder support for the work and outcomes of the project, thus improving performance. Political awareness. Described in Section 10.1.2.6. Political awareness assists the project manager in engaging stakeholders appropriately to maintain their support throughout the project.
  • 436.
    10.2.2.7 MEETINGS Meetings supportthe actions defined in the communication strategy and communications plan. 10.2.3 MANAGE COMMUNICATIONS: OUTPUTS 10.2.3.1 PROJECT COMMUNICATIONS Project communications artifacts may include but are not limited to: performance reports, deliverable status, schedule progress, cost incurred, presentations, and other information required by stakeholders. 10.2.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components of the project management plan that may be updated as a result of carrying out this process include but are not limited to: Communications management plan. Described in Section 10.1.3.1. When changes are made to the project communications approach as a result of this process, these changes are reflected in the project communications plan. Stakeholder engagement plan. Described in Section 13.2.3.1. Stakeholder communication requirements and agreed-upon communications strategies are updated as a result of this process. 10.2.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Sections 4.3.3.3. The issue log is updated to reflect any communication issues on the project, or how any communications have been used to impact active issues. Lessons learned register. Described in Section 4.3.3.1. The lessons learned register is updated with information on challenges encountered and how they could have been avoided as well as approaches that worked well and what did not work well for managing
  • 437.
    communications. Project schedule. Describedin Section 6.5.3.2. The project schedule may be updated to reflect the status of communication activities. Risk register. Described in Section 11.2.3.1. The risk register is updated to capture risks associated with managing communications. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register can be updated to include information regarding communications activities with project stakeholders. 10.2.3.4 ORGANIZATIONAL PROCESS ASSETS UPDATES Organizational process assets that may be updated as a result of this process include but are not limited to: Project records such as correspondence, memos, meeting minutes and other documents used on the project; and Planned and ad hoc project reports and presentations. 10.3 MONITOR COMMUNICATIONS Monitor Communications is the process of ensuring the information needs of the project and its stakeholders are met. The key benefit of this process is the optimal information flow as defined in the communications management plan and the stakeholder engagement plan. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 10-7. Figure 10-8 depicts the data flow diagram for the process.
  • 438.
    Monitor Communications determinesif the planned communications artifacts and activities have had the desired effect of increasing or maintaining stakeholders’ support for the project's deliverables and expected outcomes. The impact and consequences of project communications should be carefully
  • 439.
    evaluated and monitoredto ensure that the right message with the right content (the same meaning for sender and receiver) is delivered to the right audience, through the right channel, and at the right time. Monitor Communications may require a variety of methods, such as customer satisfaction surveys, collecting lessons learned, observations of the team, reviewing data from the issue log, or evaluating changes in the stakeholder engagement assessment matrix described in Section 13.2.2.5. The Monitor Communications process can trigger an iteration of the Plan Communications Management and/or Manage Communications processes to improve effectiveness of communication through additional and possibly amended communications plans and activities. Such iterations illustrate the continuous nature of the Project Communications Management processes. Issues or key performance indicators, risks, or conflicts may trigger an immediate revision. 10.3.1 MONITOR COMMUNICATIONS: INPUTS 10.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan can be used to understand the actual project organization and any changes through understanding of roles and responsibilities and the project organization charts. Communications management plan. Described in Section 10.1.3.1. The communications management plan contains the current plan for collecting, creating, and distributing information in a timely manner. It identifies the team members, stakeholders, and the work involved in the communication process. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan identifies the communication strategies that are planned to engage stakeholders. 10.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but
  • 440.
    are not limitedto: Issue log. Described in Section 4.3.3.3. The issue log provides the project's history, a record of stakeholder engagement issues, and how they were resolved. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied to later phases in the project to improve communication effectiveness. Project communications. Described in Section 10.2.3.1. Provides information about communications that have been distributed. 10.3.1.3 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on the types and quantities of communications that have actually been distributed. 10.3.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Monitor Communications process include but are not limited to: Organizational culture, political climate, and governance framework; Established communication channels, tools, and systems; Global, regional, or local trends, practices, or habits; and Geographic distribution of facilities and resources. 10.3.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that may influence the Monitor Communications process include but are not limited to: Corporate policies and procedures for social media, ethics, and security; Organizational communication requirements; Standardized guidelines for development, exchange, storage, and retrieval of information; Historical information and lessons learned repository from previous projects; and Stakeholder and communications data and information from previous
  • 441.
    projects. 10.3.2 MONITOR COMMUNICATIONS:TOOLS AND TECHNIQUES 10.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Communications with the public, the community, and the media, and, in an international environment, between virtual groups; and Communications and project management systems. 10.3.2.2 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems provides a set of standard tools for the project manager to capture, store, and distribute information to internal and external stakeholders with the information they need according the communications plan. The information contained in the system is monitored to assess its validity and effectiveness. 10.3.2.3 DATA REPRESENTATION A data representation technique that can be used includes but is not limited to the stakeholder engagement assessment matrix (Section 13.2.2.5), which can provide information about the effectiveness of the communications activities. This is achieved by reviewing changes between desired and current engagement and adjusting communications as necessary. 10.3.2.4 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to observation/conversation as described in Section 5.2.2.6. Discussion and dialogue with the project team helps determine the most appropriate way to update and communicate project performance, and to respond to requests from stakeholders for information. Observation and conversation enables the project manager to identify issues within the team, conflicts between people, or individual performance issues.
  • 442.
    10.3.2.5 MEETINGS Face-to-face orvirtual meetings are used for decision making; responding to stakeholder requests; and having discussions with suppliers, vendors, and other project stakeholders. 10.3.3 MONITOR COMMUNICATIONS: OUTPUTS 10.3.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how project communication is performing by comparing the communications that were implemented compared to those that were planned. It also considers feedback on communications, such as survey results on communication effectiveness. 10.3.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. The Monitor Communications process often results in the need for adjustment, action, and intervention on communications activities defined in the communications management plan. Change requests are processed through the Perform Integrated Change Control process (Section 4.6). These change requests may result in: Revision of stakeholder communication requirements, including stakeholders’ information distribution, content or format, and distribution method; and New procedures to eliminate bottlenecks. 10.3.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Communications management plan. Described in Section 10.1.3.1. The communications management plan is updated with new information to make communication more effective. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan is updated to reflect the actual situation
  • 443.
    of stakeholders, theircommunication needs, and their importance. 10.3.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. The issue log may be updated with new information on issues raised, their progress, and resolution. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register may be updated with causes of issues, reasons behind the corrective actions chosen, and other communication lessons learned as appropriate. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register may be updated with revised stakeholder communication requirements.
  • 444.
    11 PROJECT RISK MANAGEMENT ProjectRisk Management includes the processes of conducting risk management planning, identification, analysis, response planning, response implementation, and monitoring risk on a project. The objectives of project risk management are to increase the probability and/or impact of positive risks and to decrease the probability and/or impact of negative risks, in order to optimize the chances of project success. The Project Risk Management processes are: 11.1 Plan Risk Management—The process of defining how to conduct risk management activities for a project. 11.2 Identify Risks—The process of identifying individual project risks as well as sources of overall project risk, and documenting their characteristics. 11.3 Perform Qualitative Risk Analysis—The process of prioritizing individual project risks for further analysis or action by assessing their probability of occurrence and impact as well as other characteristics. 11.4 Perform Quantitative Risk Analysis—The process of numerically analyzing the combined effect of identified individual project risks and other sources of uncertainty on overall project objectives. 11.5 Plan Risk Responses—The process of developing options, selecting strategies, and agreeing on actions to address overall project risk exposure, as well as to treat individual project risks. 11.6 Implement Risk Responses—The process of implementing agreed-upon risk response plans. 11.7 Monitor Risks—The process of monitoring the implementation of agreed-upon risk response plans, tracking identified risks, identifying and analyzing new risks, and evaluating risk process effectiveness throughout the project. Figure 11-1 provides an overview of the Project Risk Management processes.
  • 445.
    The Project ManagementRisk processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in this PMBOK® Guide. KEY CONCEPTS FOR PROJECT RISK MANAGEMENT All projects are risky since they are unique undertakings with varying degrees of complexity that aim to deliver benefits. They do this in a context of constraints and assumptions, while responding to stakeholder expectations that may be conflicting and changing. Organizations should choose to take project risk in a controlled and intentional manner in order to create value while balancing risk and reward. Project Risk Management aims to identify and manage risks that are not addressed by the other project management processes. When unmanaged, these
  • 446.
    risks have thepotential to cause the project to deviate from the plan and fail to achieve the defined project objectives. Consequently, the effectiveness of Project Risk Management is directly related to project success. Risk exists at two levels within every project. Each project contains individual risks that can affect the achievement of project objectives. It is also important to consider the riskiness of the overall project, which arises from the combination of individual project risks and other sources of uncertainty. Project Risk Management processes address both levels of risk in projects, and these are defined as follows: Individual project risk is an uncertain event or condition that, if it occurs, has a positive or negative effect on one or more project objectives. Overall project risk is the effect of uncertainty on the project as a whole, arising from all sources of uncertainty including individual risks, representing the exposure of stakeholders to the implications of variations in project outcome, both positive and negative. Individual project risks can have a positive or negative effect on project objectives if they occur. Project Risk Management aims to exploit or enhance positive risks (opportunities) while avoiding or mitigating negative risks (threats). Unmanaged threats may result in issues or problems such as delay, cost overruns, performance shortfall, or loss of reputation. Opportunities that are captured can lead to benefits such as reduced time and cost, improved performance, or reputation. Overall project risk can also be positive or negative. Management of overall project risk aims to keep project risk exposure within an acceptable range by reducing drivers of negative variation, promoting drivers of positive variation, and maximizing the probability of achieving overall project objectives. Risks will continue to emerge during the lifetime of the project, so Project Risk Management processes should be conducted iteratively. Risk is initially addressed during project planning by shaping the project strategy. Risk should also be monitored and managed as the project progresses to ensure that the project stays on track and emergent risks are addressed. In order to manage risk effectively on a particular project, the project team needs to know what level of risk exposure is acceptable in pursuit of the project objectives. This is defined by measurable risk thresholds that reflect the risk appetite of the organization and project stakeholders. Risk thresholds express the
  • 447.
    degree of acceptablevariation around a project objective. They are explicitly stated and communicated to the project team and reflected in the definitions of risk impact levels for the project. TRENDS AND EMERGING PRACTICES IN PROJECT RISK MANAGEMENT The focus of project risk management is broadening to ensure that all types of risk are considered, and that project risks are understood in a wider context. Trends and emerging practices for Project Risk Management include but are not limited to: Non-event risks. Most projects focus only on risks that are uncertain future events that may or may not occur. Examples of event-based risks include: a key seller may go out of business during the project, the customer may change the requirement after design is complete, or a subcontractor may propose enhancements to the standard operating processes. There is an increasing recognition that non-event risks need to be identified and managed. There are two main types of non-event risks: Variability risk. Uncertainty exists about some key characteristics of a planned event or activity or decision. Examples of variability risks include: productivity may be above or below target, the number of errors found during testing may be higher or lower than expected, or unseasonal weather conditions may occur during the construction phase. Ambiguity risk. Uncertainty exists about what might happen in the future. Areas of the project where imperfect knowledge might affect the project's ability to achieve its objectives include: elements of the requirement or technical solution, future developments in regulatory frameworks, or inherent systemic complexity in the project. Variability risks can be addressed using Monte Carlo analysis, with the range of variation reflected in probability distributions, followed by actions to reduce the spread of possible outcomes. Ambiguity risks are managed by defining those areas where there is a deficit of knowledge or understanding, then filling the gap by obtaining expert external input or benchmarking against best practices. Ambiguity is also addressed through incremental development, prototyping, or simulation.
  • 448.
    Project resilience. Theexistence of emergent risk is becoming clear, with a growing awareness of so-called unknowable-unknowns. These are risks that can only be recognized after they have occurred. Emergent risks can be tackled through developing project resilience. This requires each project to have: Right level of budget and schedule contingency for emergent risks, in addition to a specific risk budget for known risks; Flexible project processes that can cope with emergent risk while maintaining overall direction toward project goals, including strong change management; Empowered project team that has clear objectives and that is trusted to get the job done within agreed-upon limits; Frequent review of early warning signs to identify emergent risks as early as possible; and Clear input from stakeholders to clarify areas where the project scope or strategy can be adjusted in response to emergent risks. Integrated risk management. Projects exist in an organizational context, and they may form part of a program or portfolio. Risk exists at each of these levels, and risks should be owned and managed at the appropriate level. Some risks identified at higher levels will be delegated to the project team for management, and some project risks may be escalated to higher levels if they are best managed outside the project. A coordinated approach to enterprise-wide risk management ensures alignment and coherence in the way risk is managed across all levels. This builds risk efficiency into the structure of programs and portfolios, providing the greatest overall value for a given level of risk exposure. TAILORING CONSIDERATIONS Because each project is unique, it is necessary to tailor the way Project Risk Management processes are applied. Considerations for tailoring include but are not limited to: Project size. Does the project's size in terms of budget, duration, scope, or team size require a more detailed approach to risk management? Or is it small enough to justify a simplified risk process?
  • 449.
    Project complexity. Isa robust risk approach demanded by high levels of innovation, new technology, commercial arrangements, interfaces, or external dependencies that increase project complexity? Or is the project simple enough that a reduced risk process will suffice? Project importance. How strategically important is the project? Is the level of risk increased for this project because it aims to produce breakthrough opportunities, addresses significant blocks to organizational performance, or involves major product innovation? Development approach. Is this a waterfall project, where risk processes can be followed sequentially and iteratively, or does the project follow an agile approach where risk is addressed at the start of each iteration as well as during its execution? Tailoring of the Project Risk Management processes to meet these considerations is part of the Plan Risk Management process, and the outcomes of tailoring decisions are recorded in the risk management plan. CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS High-variability environments, by definition, incur more uncertainty and risk. To address this, projects managed using adaptive approaches make use of frequent reviews of incremental work products and cross-functional project teams to accelerate knowledge sharing and ensure that risk is understood and managed. Risk is considered when selecting the content of each iteration, and risks will also be identified, analyzed, and managed during each iteration. Additionally, the requirements are kept as a living document that is updated regularly, and work may be reprioritized as the project progresses, based on an improved understanding of current risk exposure. 11.1 PLAN RISK MANAGEMENT Plan Risk Management is the process of defining how to conduct risk management activities for a project. The key benefit of this process is that it ensures that the degree, type, and visibility of risk management are proportionate to both risks and the importance of the project to the organization and other stakeholders. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-2. Figure 11-3 depicts the data flow diagram for the process.
  • 450.
    The Plan RiskManagement process should begin when a project is conceived and should be completed early in the project. It may be necessary to revisit this process later in the project life cycle, for example at a major phase change, or if the project scope changes significantly, or if a subsequent review of risk management effectiveness determines that the Project Risk Management process requires modification.
  • 451.
    11.1.1 PLAN RISKMANAGEMENT: INPUTS 11.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter documents the high-level project description and boundaries, high-level requirements, and risks. 11.1.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. In planning Project Risk Management, all approved subsidiary management plans should be taken into consideration in order to make the risk management plan consistent with them. The methodology outlined in other project management plan components might influence the Plan Risk Management process. 11.1.1.3 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to the stakeholder register as described in Section 13.1.3.1. The stakeholder register contains details of the project's stakeholders and provides an overview of their project roles and their attitude toward risk on this project. This is useful in determining roles and responsibilities for managing risk on the project, as well as setting risk thresholds for the project. 11.1.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Risk Management process include but are not limited to overall risk thresholds set by the organization or key stakeholders. 11.1.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Risk Management process include but are not limited to: Organizational risk policy; Risk categories, possibly organized into a risk breakdown structure; Common definitions of risk concepts and terms; Risk statement formats; Templates for the risk management plan, risk register, and risk report;
  • 452.
    Roles and responsibilities; Authoritylevels for decision making; and Lessons learned repository from previous similar projects. 11.1.2 PLAN RISK MANAGEMENT: TOOLS AND TECHNIQUES 11.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Familiarity with the organization's approach to managing risk, including enterprise risk management where this is performed; Tailoring risk management to the specific needs of a project; and Types of risk that are likely to be encountered on projects in the same area. 11.1.2.2 DATA ANALYSIS Data analysis techniques that can be used for this process includes but are not limited to a stakeholder analysis (Section 13.1.2.3) to determine the risk appetite of project stakeholders. 11.1.2.3 MEETINGS The risk management plan may be developed as part of the project kick-off meeting or a specific planning meeting may be held. Attendees may include the project manager, selected project team members, key stakeholders, or team members who are responsible to manage the risk management process on the project. Others outside the organization may also be invited, as needed, including customers, sellers, and regulators. A skilled facilitator can help participants remain focused on the task, agree on key aspects of the risk approach, identify and overcome sources of bias, and resolve any disagreements that may arise. Plans for conducting risk management activities are defined in these meetings and documented in the risk management plan (see Section 11.1.3.1).
  • 453.
    11.1.3 PLAN RISKMANAGEMENT: OUTPUTS 11.1.3.1 RISK MANAGEMENT PLAN The risk management plan is a component of the project management plan that describes how risk management activities will be structured and performed. The risk management plan may include some or all of the following elements: Risk strategy. Describes the general approach to managing risk on this project. Methodology. Defines the specific approaches, tools, and data sources that will be used to perform risk management on the project. Roles and responsibilities. Defines the lead, support, and risk management team members for each type of activity described in the risk management plan, and clarifies their responsibilities. Funding. Identifies the funds needed to perform activities related to Project Risk Management. Establishes protocols for the application of contingency and management reserves. Timing. Defines when and how often the Project Risk Management processes will be performed throughout the project life cycle, and establishes risk management activities for inclusion into the project schedule. Risk categories. Provide a means for grouping individual project risks. A common way to structure risk categories is with a risk breakdown structure (RBS), which is a hierarchical representation of potential sources of risk (see example in Figure 11-4). An RBS helps the project team consider the full range of sources from which individual project risks may arise. This can be useful when identifying risks or when categorizing identified risks. The organization may have a generic RBS to be used for all projects, or there may be several RBS frameworks for different types of projects, or the project may develop a tailored RBS. Where an RBS is not used, an organization may use a custom risk categorization framework, which may take the form of a simple list of categories or a structure based on project objectives.
  • 454.
    Stakeholder risk appetite.The risk appetites of key stakeholders on the project are recorded in the risk management plan, as they inform the details of the Plan Risk Management process. In particular, stakeholder risk appetite should be expressed as measurable risk thresholds around each project objective. These thresholds will determine the acceptable level of overall project risk exposure, and they are also used to inform the definitions of probability and impacts to be used when assessing and prioritizing individual project risks. Definitions of risk probability and impacts. Definitions of risk probability and impact levels are specific to the project context and reflect the risk appetite and thresholds of the organization and key stakeholders. The project may generate specific definitions of
  • 455.
    probability and impactlevels or it may start with general definitions provided by the organization. The number of levels reflects the degree of detail required for the Project Risk Management process, with more levels used for a more detailed risk approach (typically five levels), and fewer for a simple process (usually three). Table 11-1 provides an example of definitions of probability and impacts against three project objectives. These scales can be used to evaluate both threats and opportunities by interpreting the impact definitions as negative for threats (delay, additional cost, and performance shortfall) and positive for opportunities (reduced time or cost, and performance enhancement). Probability and impact matrix. Described in Section 11.3.2.6. Prioritization rules may be specified by the organization in advance of the project and be included in organizational process assets, or they may be tailored to the specific project. Opportunities and threats are represented in a common probability and impact matrix using positive definitions of impact for opportunities and negative impact definitions for threats. Descriptive terms (such as very high, high, medium, low, and very low) or numeric values can be used for probability and impact. Where numeric values are used, these can be multiplied to give a probability-impact score for each risk, which allows the relative priority of individual risks to be evaluated within each priority level. An example probability and impact matrix is presented in Figure 11-5, which also shows a possible numeric risk scoring scheme.
  • 456.
    Reporting formats. Reportingformats define how the outcomes of the Project Risk Management process will be documented, analyzed, and communicated. This section of the risk management plan describes the content and format of the risk register and the risk report, as well as any other required outputs from the Project Risk Management processes. Tracking. Tracking documents how risk activities will be recorded and how risk management processes will be audited. 11.2 IDENTIFY RISKS Identify Risks is the process of identifying individual project risks as well as sources of overall project risk, and documenting their characteristics. The key benefit of this process is the documentation of existing individual project risks and the sources of overall project risk. It also brings together information so the project team can respond appropriately to identified risks. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-6. Figure 11-7 depicts the data flow diagram for the process.
  • 458.
    Identify Risks considersboth individual project risks and sources of overall project risk. Participants in risk identification activities may include the following: project manager, project team members, project risk specialist (if assigned), customers, subject matter experts from outside the project team, end users, other project managers, operations managers, stakeholders, and risk management experts within the organization. While these personnel are often key participants for risk identification, all project stakeholders should be encouraged to identify individual project risks. It is particularly important to involve the project team so they can develop and maintain a sense of ownership and responsibility for identified individual project risks, the level of overall project risk, and associated risk response actions. When describing and recording individual project risks, a consistent format should be used for risk statements to ensure that each risk is understood clearly
  • 459.
    and unambiguously inorder to support effective analysis and risk response development. Risk owners for individual project risks may be nominated as part of the Identify Risks process, and will be confirmed during the Perform Qualitative Risk Analysis process. Preliminary risk responses may also be identified and recorded and will be reviewed and confirmed as part of the Plan Risk Responses process. Identify Risks is an iterative process, since new individual project risks may emerge as the project progresses through its life cycle and the level of overall project risk will also change. The frequency of iteration and participation in each risk identification cycle will vary by situation, and this will be defined in the risk management plan. 11.2.1 IDENTIFY RISKS: INPUTS 11.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Requirements management plan. Described in Section 5.1.3.2. The requirements management plan may indicate project objectives that are particularly at risk. Schedule management plan. Described in Section 6.1.3.1. The schedule management plan may identify areas that are subject to uncertainty or ambiguity. Cost management plan. Described in Section 7.1.3.1. The cost management plan may identify areas that are subject to uncertainty or ambiguity. Quality management plan. Described in Section 8.1.3.1. The quality management plan may identify areas that are subject to uncertainty or ambiguity, or where key assumptions have been made that might give rise to risk. Resource management plan. Described in Section 9.1.3.1. The resource management plan may identify areas that are subject to uncertainty or ambiguity, or where key assumptions have been made that might give rise to risk. Risk management plan. Described in Section 11.1.3.1. The risk
  • 460.
    management plan providesinformation on risk-related roles and responsibilities, indicates how risk management activities are included in the budget and schedule, and describes categories of risk, which may be expressed as a risk breakdown structure (Figure 11-4). Scope baseline. Described in Section 5.4.3.1. The scope baseline includes deliverables and criteria for their acceptance, some of which might give rise to risk. It also contains the WBS, which can be used as a framework to structure risk identification techniques. Schedule baseline. Described in Section 6.5.3.1. The schedule baseline may be reviewed to identify milestones and deliverable due dates that are subject to uncertainty or ambiguity, or where key assumptions have been made that might give rise to risk. Cost baseline. Described in Section 7.3.3.1. The cost baseline may be reviewed to identify costs or funding requirements that are subject to uncertainty or ambiguity, or where key assumptions have been made that might give rise to risk. 11.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. Assumptions and constraints recorded in the assumption log may give rise to individual project risks and may also influence the level of overall project risk. Cost estimates. Described in Section 7.2.3.1. Cost estimates provide quantitative assessments of project costs, ideally expressed as a range, indicating the degree of risk, where a structured review of the documents may indicate that the current estimate is insufficient and poses a risk to the project. Duration estimates. Described in Section 6.4.3.1. Duration estimates provide quantitative assessments of project durations, ideally expressed as a range, indicating the degree of risk, where a structured review of the documents may indicate that the current estimate is insufficient and poses a risk to the project. Issue log. Described in Section 4.3.3.3. Issues recorded in the issue log may give rise to individual project risks and may also influence the level of overall project risk.
  • 461.
    Lessons learned register.Described in Section 4.4.3.1. Lessons learned about risk identified from earlier phases of the project are reviewed to determine whether similar risks might recur during the remainder of the project. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation lists the project requirements and allows the team to identify those that could be at risk. Resource requirements. Described in Section 9.2.3.1. Resource requirements provide quantitative assessments of project resource requirements, ideally expressed as a range, indicating the degree of risk, where a structured review of the documents may indicate that the current estimate is insufficient and poses a risk to the project. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register indicates which individuals or groups might participate in identifying risks to the project. It also details those individuals who are available to act as risk owners. 11.2.1.3 AGREEMENTS Described in Section 12.2.3.2. If the project requires external procurement of resources, the agreements may have information such as milestone dates, contract type, acceptance criteria, and awards and penalties that can present threats or opportunities. 11.2.1.4 PROCUREMENT DOCUMENTATION Described in Section 12.3.1.4. If the project requires external procurement of resources, the initial procurement documentation should be reviewed as procuring goods and services from outside the organization may increase or decrease overall project risk and may introduce additional individual project risks. As the procurement documentation is updated throughout the project, the most up to date documentation can be reviewed for risks. For example, seller performance reports, approved change requests and information on inspections. 11.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Identify Risks process include but are not limited to:
  • 462.
    Published material, includingcommercial risk databases or checklists, Academic studies, Benchmarking results, and Industry studies of similar projects. 11.2.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Identify Risks process include but are not limited to: Project files, including actual data, Organizational and project process controls, Risk statement formats, and Checklists from previous similar projects. 11.2.2 IDENTIFY RISKS: TOOLS AND TECHNIQUES 11.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge of similar projects or business areas. Such experts should be identified by the project manager and invited to consider all aspects of individual project risks as well as sources of overall project risk, based on their previous experience and areas of expertise. The experts’ bias should be taken into account in this process. 11.2.2.2 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to: Brainstorming. The goal of brainstorming (see Section 4.1.2.2) is to obtain a comprehensive list of individual project risks and sources of overall project risk. The project team usually performs brainstorming, often with a multidisciplinary set of experts who are not part of the team. Ideas are generated under the guidance of a facilitator, either in a free-form brainstorm session or one that uses more structured techniques. Categories of risk, such as in a risk breakdown structure,
  • 463.
    can be usedas a framework. Particular attention should be paid to ensuring that risks identified through brainstorming are clearly described, since the technique can result in ideas that are not fully formed. Checklists. A checklist is a list of items, actions, or points to be considered. It is often used as a reminder. Risk checklists are developed based on historical information and knowledge that has been accumulated from similar projects and from other sources of information. They are an effective way to capture lessons learned from similar completed projects, listing specific individual project risks that have occurred previously and that may be relevant to this project. The organization may maintain a risk checklist based on its own completed projects or may use generic risk checklists from the industry. While a checklist may be quick and simple to use, it is impossible to build an exhaustive one, and care should be taken to ensure the checklist is not used to avoid the effort of proper risk identification. The project team should also explore items that do not appear on the checklist. Additionally, the checklist should be reviewed from time to time to update new information as well as remove or archive obsolete information. Interviews. Individual project risks and sources of overall project risk can be identified by interviewing experienced project participants, stakeholders, and subject matter experts. Interviews (see Section 5.2.2.2) should be conducted in an environment of trust and confidentiality to encourage honest and unbiased contributions. 11.2.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Root cause analysis. Root cause analysis (see Section 8.2.2.2) is typically used to discover the underlying causes that lead to a problem, and develop preventive action. It can be used to identify threats by starting with a problem statement (for example, the project might be delayed or over budget) and exploring which threats might result in that problem occurring. The same technique can be used to find opportunities by starting with a benefit statement (for example, early delivery or under budget) and exploring which opportunities might
  • 464.
    result in thatbenefit being realized. Assumption and constraint analysis. Every project and its project management plan are conceived and developed based on a set of assumptions and within a series of constraints. These are often already incorporated in the scope baseline and project estimates. Assumption and constraint analysis explores the validity of assumptions and constraints to determine which pose a risk to the project. Threats may be identified from the inaccuracy, instability, inconsistency, or incompleteness of assumptions. Constraints may give rise to opportunities through removing or relaxing a limiting factor that affects the execution of a project or process. SWOT analysis. This technique examines the project from each of the strengths, weaknesses, opportunities, and threats (SWOT) perspectives. For risk identification, it is used to increase the breadth of identified risks by including internally generated risks. The technique starts with the identification of strengths and weaknesses of the organization, focusing on either the project, organization, or the business area in general. SWOT analysis then identifies any opportunities for the project that may arise from strengths, and any threats resulting from weaknesses. The analysis also examines the degree to which organizational strengths may offset threats and determines if weaknesses might hinder opportunities. Document analysis. Described in Section 5.2.2.3. Risks may be identified from a structured review of project documents, including, but not limited to, plans, assumptions, constraints, previous project files, contracts, agreements, and technical documentation. Uncertainty or ambiguity in project documents, as well as inconsistencies within a document or between different documents, may be indicators of risk on the project. 11.2.2.4 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process includes but are not limited to facilitation (see Section 4.1.2.3). Facilitation improves the effectiveness of many of the techniques used to identify individual project risks and sources of overall project risk. A skilled facilitator can help participants remain focused on the risk identification task, follow the method associated with the technique accurately, ensure clear risk descriptions, identify and overcome
  • 465.
    sources of bias,and resolve any disagreements that may arise. 11.2.2.5 PROMPT LISTS A prompt list is a predetermined list of risk categories that might give rise to individual project risks and that could also act as sources of overall project risk. The prompt list can be used as a framework to aid the project team in idea generation when using risk identification techniques. The risk categories in the lowest level of the risk breakdown structure can be used as a prompt list for individual project risks. Some common strategic frameworks are more suitable for identifying sources of overall project risk, for example PESTLE (political, economic, social, technological, legal, environmental), TECOP (technical, environmental, commercial, operational, political), or VUCA (volatility, uncertainty, complexity, ambiguity). 11.2.2.6 MEETINGS To undertake risk identification, the project team may conduct a specialized meeting (often called a risk workshop). Most risk workshops include some form of brainstorming (see Section 4.1.2.2), but other risk identification techniques may be included depending on the level of the risk process defined in the risk management plan. Use of a skilled facilitator will increase the effectiveness of the meeting. It is also essential to ensure that the right people participate in the risk workshop. On larger projects, it may be appropriate to invite the project sponsor, subject matter experts, sellers, representatives of the customer, or other project stakeholders. Risk workshops for smaller projects may be restricted to a subset of the project team. 11.2.3 IDENTIFY RISKS: OUTPUTS 11.2.3.1 RISK REGISTER The risk register captures details of identified individual project risks. The results of Perform Qualitative Risk Analysis, Plan Risk Responses, Implement Risk Responses, and Monitor Risks are recorded in the risk register as those processes are conducted throughout the project. The risk register may contain limited or extensive risk information depending on project variables such as size and complexity. On completion of the Identify Risks process, the content of the risk register
  • 466.
    may include butis not limited to: List of identified risks. Each individual project risk is given a unique identifier in the risk register. Identified risks are described in as much detail as required to ensure unambiguous understanding. A structured risk statement may be used to distinguish risks from their cause(s) and their effect(s). Potential risk owners. Where a potential risk owner has been identified during the Identify Risks process, the risk owner is recorded in the risk register. This will be confirmed during the Perform Qualitative Risk Analysis process. List of potential risk responses. Where a potential risk response has been identified during the Identify Risks process, it is recorded in the risk register. This will be confirmed during the Plan Risk Responses process. Additional data may be recorded for each identified risk, depending on the risk register format specified in the risk management plan. This may include: a short risk title, risk category, current risk status, one or more causes, one or more effects on objectives, risk triggers (events or conditions that indicate that a risk is about to occur), WBS reference of affected activities, and timing information (when was the risk identified, when might the risk occur, when might it no longer be relevant, and what is the deadline for taking action). 11.2.3.2 RISK REPORT The risk report presents information on sources of overall project risk, together with summary information on identified individual project risks. The risk report is developed progressively throughout the Project Risk Management process. The results of Perform Qualitative Risk Analysis, Perform Quantitative Risk Analysis, Plan Risk Responses, Implement Risk Responses, and Monitor Risks are also included in the risk report as those processes are completed. On completion of the Identify Risks process, information in the risk report may include but is not limited to: Sources of overall project risk, indicating which are the most important drivers of overall project risk exposure; and Summary information on identified individual project risks, such as number of identified threats and opportunities, distribution of risks across risk categories, metrics and trends, etc.
  • 467.
    Additional information maybe included in the risk report, depending on the reporting requirements specified in the risk management plan. 11.2.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. During the Identify Risks process, new assumptions may be made, new constraints may be identified, and existing assumptions or constraints may be revisited and changed. The assumption log should be updated with this new information. Issue log. Described in Section 4.3.3.3. The issue log should be updated to capture any new issues uncovered or changes in currently logged issues. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with information on techniques that were effective in identifying risks to improve performance in later phases or other projects. 11.3 PERFORM QUALITATIVE RISK ANALYSIS Perform Qualitative Risk Analysis is the process of prioritizing individual project risks for further analysis or action by assessing their probability of occurrence and impact as well as other characteristics. The key benefit of this process is that it focuses efforts on high-priority risks. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-8. Figure 11-9 depicts the data flow diagram for the process.
  • 468.
    Perform Qualitative RiskAnalysis assesses the priority of identified individual project risks using their probability of occurrence, the corresponding impact on project objectives if the risks occur, and other factors. Such assessments are subjective as they are based on perceptions of risk by the project team and other stakeholders. Effective assessment therefore requires explicit identification and management of the risk attitudes of key participants in the
  • 469.
    Perform Qualitative RiskAnalysis process. Risk perception introduces bias into the assessment of identified risks, so attention should be paid to identifying bias and correcting for it. Where a facilitator is used to support the Perform Qualitative Risk Analysis process, addressing bias is a key part of the facilitator's role. An evaluation of the quality of the available information on individual project risks also helps to clarify the assessment of each risk's importance to the project. Perform Qualitative Risk Analysis establishes the relative priorities of individual project risks for Plan Risk Responses. It identifies a risk owner for each risk who will take responsibility for planning an appropriate risk response and ensuring that it is implemented. Perform Qualitative Risk Analysis also lays the foundation for Perform Quantitative Risk Analysis if this process is required. The Perform Qualitative Risk Analysis process is performed regularly throughout the project life cycle, as defined in the risk management plan. Often, in an agile development environment, the Perform Qualitative Risk Analysis process is conducted before the start of each iteration. 11.3.1 PERFORM QUALITATIVE RISK ANALYSIS: INPUTS 11.3.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include the risk management plan as described in Section 11.1.3.1. Of particular interest in this process are the roles and responsibilities for conducting risk management, budgets for risk management, schedule activities for risk management, risk categories (often defined in a risk breakdown structure), definitions of probability and impact, the probability and impact matrix, and stakeholders’ risk thresholds. These inputs are usually tailored to the project during the Plan Risk Management process. If they are not available, they may be developed during the Perform Qualitative Risk Analysis process and presented to the project sponsor for approval before use. 11.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log is
  • 470.
    used for identifying,managing, and monitoring key assumptions and constraints that may affect the project. These may inform the assessment of the priority of individual project risks. Risk register. Described in Section 11.2.3.1. The risk register contains details of each identified individual project risk that will be assessed during the Perform Qualitative Risk Analysis process. Stakeholder register. Described in Section 13.1.3.1. This includes details of project stakeholders who may be nominated as risk owners. 11.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence Perform Qualitative Risk Analysis include but are not limited to: Industry studies of similar projects, and Published material, including commercial risk databases or checklists. 11.3.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence Perform Qualitative Risk Analysis include but are not limited to information from similar completed projects. 11.3.2 PERFORM QUALITATIVE RISK ANALYSIS: TOOLS AND TECHNIQUES 11.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Previous similar projects, and Qualitative risk analysis. Expert judgment is often obtained through facilitated risk workshops or interviews. The possibility of expert views being biased should be taken into account in this process. 11.3.2.2 DATA GATHERING
  • 471.
    Data-gathering techniques thatcan be used for this process include but are not limited to interviews. Structured or semi-structured interviews (Section 5.2.2.2) can be used to assess the probability and impacts of individual project risks, as well as other factors. The interviewer should promote an environment of trust and confidentiality in the interview setting to encourage honest and unbiased assessments. 11.3.2.3 DATA ANALYSIS Data analysis techniques that can be used during this process include but are not limited to: Risk data quality assessment. Risk data quality assessment evaluates the degree to which the data about individual project risks is accurate and reliable as a basis for qualitative risk analysis. The use of low- quality risk data may lead to a qualitative risk analysis that is of little use to the project. If data quality is unacceptable, it may be necessary to gather better data. Risk data quality may be assessed via a questionnaire measuring the project's stakeholder perceptions of various characteristics, which may include completeness, objectivity, relevancy, and timeliness. A weighted average of selected data quality characteristics can then be generated to give an overall quality score. Risk probability and impact assessment. Risk probability assessment considers the likelihood that a specific risk will occur. Risk impact assessment considers the potential effect on one or more project objectives such as schedule, cost, quality, or performance. Impacts will be negative for threats and positive for opportunities. Probability and impact are assessed for each identified individual project risk. Risks can be assessed in interviews or meetings with participants selected for their familiarity with the types of risk recorded in the risk register. Project team members and knowledgeable persons external to the project are included. The level of probability for each risk and its impact on each objective are evaluated during the interview or meeting. Differences in the levels of probability and impact perceived by stakeholders are to be expected, and such differences should be explored. Explanatory detail, including assumptions justifying the levels assigned, are also recorded. Risk probabilities and impacts are assessed using the definitions given in the risk management plan (see Table 11-1). Risks with low probability and impact may be included
  • 472.
    within the riskregister as part of a watch list for future monitoring. Assessment of other risk parameters. The project team may consider other characteristics of risk (in addition to probability and impact) when prioritizing individual project risks for further analysis and action. These characteristics may include but are not limited to: Urgency. The period of time within which a response to the risk is to be implemented in order to be effective. A short period indicates high urgency. Proximity. The period of time before the risk might have an impact on one or more project objectives. A short period indicates high proximity. Dormancy. The period of time that may elapse after a risk has occurred before its impact is discovered. A short period indicates low dormancy. Manageability. The ease with which the risk owner (or owning organization) can manage the occurrence or impact of a risk. Where management is easy, manageability is high. Controllability. The degree to which the risk owner (or owning organization) is able to control the risk's outcome. Where the outcome can be easily controlled, controllability is high. Detectability. The ease with which the results of the risk occurring, or being about to occur, can be detected and recognized. Where the risk occurrence can be detected easily, detectability is high. Connectivity. The extent to which the risk is related to other individual project risks. Where a risk is connected to many other risks, connectivity is high. Strategic impact. The potential for the risk to have a positive or negative effect on the organization's strategic goals. Where the risk has a major effect on strategic goals, strategic impact is high. Propinquity. The degree to which a risk is perceived to matter by one or more stakeholders. Where a risk is perceived as very significant, propinquity is high. The consideration of some of these characteristics can provide a more robust prioritization of risks than is possible by only assessing probability and impact.
  • 473.
    11.3.2.4 INTERPERSONAL ANDTEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to facilitation (see Section 4.1.2.3). Facilitation improves the effectiveness of the qualitative analysis of individual project risks. A skilled facilitator can help participants remain focused on the risk analysis task, follow the method associated with the technique accurately, reach consensus on assessments of probability and impacts, identify and overcome sources of bias, and resolve any disagreements that may arise. 11.3.2.5 RISK CATEGORIZATION Risks to the project can be categorized by sources of risk (e.g., using the risk breakdown structure (RBS); see Figure 11-4), the area of the project affected (e.g., using the work breakdown structure (WBS); see Figures 5-12, 5-13, and 5- 14), or other useful categories (e.g., project phase, project budget, and roles and responsibilities) to determine the areas of the project most exposed to the effects of uncertainty. Risks can also be categorized by common root causes. Risk categories that may be used for the project are defined in the risk management plan. Grouping risks into categories can lead to the development of more effective risk responses by focusing attention and effort on the areas of highest risk exposure, or by developing generic risk responses to address groups of related risks. 11.3.2.6 DATA REPRESENTATION Data representation techniques that can be used during this process include but are not limited to: Probability and impact matrix. A probability and impact matrix is a grid for mapping the probability of each risk occurrence and its impact on project objectives if that risk occurs. This matrix specifies combinations of probability and impact that allow individual project risks to be divided into priority groups (see Figure 11-5). Risks can be prioritized for further analysis and planning of risk responses based on their probability and impacts. The probability of occurrence for each individual project risk is assessed as well as its impact on one or more project objectives if it does occur, using definitions of probability and impact for the project as specified in the risk management plan.
  • 474.
    Individual project risksare assigned to a priority level based on the combination of their assessed probability and impact, using a probability and impact matrix. An organization can assess a risk separately for each objective (e.g., cost, time, and scope) by having a separate probability and impact matrix for each. Alternatively, it may develop ways to determine one overall priority level for each risk, either by combining assessments for different objectives, or by taking the highest priority level regardless of which objective is affected. Hierarchical charts. Where risks have been categorized using more than two parameters, the probability and impact matrix cannot be used and other graphical representations are required. For example, a bubble chart displays three dimensions of data, where each risk is plotted as a disk (bubble), and the three parameters are represented by the x-axis value, the y-axis value, and the bubble size. An example bubble chart is shown in Figure 11-10, with detectability and proximity plotted on the x and y axes, and impact value represented by bubble size.
  • 475.
    11.3.2.7 MEETINGS To undertakequalitative risk analysis, the project team may conduct a specialized meeting (often called a risk workshop) dedicated to the discussion of identified individual project risks. The goals of this meeting include the review of previously identified risks, assessment of probability and impacts (and possibly other risk parameters), categorization, and prioritization. A risk owner, who will be responsible for planning an appropriate risk response and for reporting progress on managing the risk, will be allocated to each individual project risk as part of the Perform Qualitative Risk Analysis process. The meeting may start by reviewing and confirming the probability and impact scales to be used for the analysis. The meeting may also identify additional risks during the discussion, and these should be recorded for analysis. Use of a skilled facilitator will increase the effectiveness of the meeting.
  • 476.
    11.3.3 PERFORM QUALITATIVERISK ANALYSIS: OUTPUTS 11.3.3.1 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. During the Perform Qualitative Risk Analysis process, new assumptions may be made, new constraints may be identified, and existing assumptions or constraints may be revisited and changed. The assumption log should be updated with this new information. Issue log. Described in Section 4.3.3.3. The issue log should be updated to capture any new issues uncovered or changes in currently logged issues. Risk register. Described in Section 11.2.3.1. The risk register is updated with new information generated during the Perform Qualitative Risk Analysis process. Updates to the risk register may include assessments of probability and impacts for each individual project risk, its priority level or risk score, the nominated risk owner, risk urgency information or risk categorization, and a watch list for low-priority risks or risks requiring further analysis. Risk report. Described in Section 11.2.3.2. The risk report is updated to reflect the most important individual project risks (usually those with the highest probability and impact), as well as a prioritized list of all identified risks on the project and a summary conclusion. 11.4 PERFORM QUANTITATIVE RISK ANALYSIS Perform Quantitative Risk Analysis is the process of numerically analyzing the combined effect of identified individual project risks and other sources of uncertainty on overall project objectives. The key benefit of this process is that it quantifies overall project risk exposure, and it can also provide additional quantitative risk information to support risk response planning. This process is not required for every project, but where it is used, it is performed throughout the project. The inputs and outputs of this process are depicted in Figure 11-11. Figure 11-12 depicts the data flow diagram for the process.
  • 478.
    Perform Quantitative RiskAnalysis is not required for all projects. Undertaking a robust analysis depends on the availability of high-quality data about individual project risks and other sources of uncertainty, as well as a sound underlying project baseline for scope, schedule, and cost. Quantitative risk analysis usually requires specialized risk software and expertise in the development and interpretation of risk models. It also consumes additional time and cost. The use of quantitative risk analysis for a project will be specified in the project's risk management plan. It is most likely appropriate for large or complex projects, strategically important projects, projects for which it is a contractual requirement, or projects in which a key stakeholder requires it. Quantitative risk analysis is the only reliable method to assess overall project risk through evaluating the aggregated effect on project outcomes of all individual project risks and other sources of uncertainty. Perform Quantitative Risk Analysis uses information on individual project risks that have been assessed by the Perform Qualitative Risk Analysis process as having a significant potential to affect the project's objectives. Outputs from Perform Quantitative Risk Analysis are used as inputs to the Plan Risk Responses process, particularly in recommending responses to the level of overall project risk and key individual risks. A quantitative risk analysis may also be undertaken following the Plan Risk Responses process, to determine the likely effectiveness of planned responses in reducing overall project risk exposure. 11.4.1 PERFORM QUANTITATIVE RISK ANALYSIS: INPUTS 11.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Risk management plan. Described in Section 11.1.3.1. The risk management plan specifies whether quantitative risk analysis is required for the project. It also details the resources available for the analysis and the expected frequency of analyses. Scope baseline. Described in Section 5.4.3.1. The scope baseline describes the starting point from which the effect of individual project risks and other sources of uncertainty are evaluated.
  • 479.
    Schedule baseline. Describedin Section 6.5.3.1. The schedule baseline describes the starting point from which the effect of individual project risks and other sources of uncertainty can be evaluated. Cost baseline. Described in Section 7.3.3.1. The cost baseline describes the starting point from which the effect of individual project risks and other sources of uncertainty can be evaluated. 11.4.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. Assumptions may form inputs to the quantitative risk analysis if they are assessed as posing a risk to project objectives. The effect of constraints may also be modeled during a quantitative risk analysis. Basis of estimates. Described in Sections 6.4.3.2 and 7.2.3.2. The basis of estimates used in the planning of the project may be reflected in variability modeled during a quantitative risk analysis process. This may include information on the estimate's purpose, classification, assumed accuracy, methodology, and source. Cost estimates. Described in Section 7.2.3.1. Cost estimates provide the starting point from which cost variability is evaluated. Cost forecasts. Described in Section 7.4.3.2. Forecasts such as the project's estimate to complete (ETC), estimate at completion (EAC), budget at completion (BAC), and to-complete performance index (TCPI) may be compared to the results of a quantitative cost risk analysis to determine the confidence level associated with achieving these targets. Duration estimates. Described in Section 6.4.3.1. Duration estimates provide the starting point from which schedule variability is evaluated. Milestone list. Described in Section 6.2.3.3. Significant events in the project define the schedule targets against which the results of a quantitative schedule risk analysis are compared, in order to determine the confidence level associated with achieving these targets. Resource requirements. Described in Section 9.2.3.1. Resource requirements provide the starting point from which variability is
  • 480.
    evaluated. Risk register. Describedin Section 11.2.3.1. The risk register contains details of individual project risks to be used as input for quantitative risk analysis. Risk report. Described in Section 11.2.3.2. The risk report describes sources of overall project risk and the current overall project risk status. Schedule forecasts. Described in Section 6.6.3.2. Forecasts may be compared to the results of a quantitative schedule risk analysis to determine the confidence level associated with achieving these targets. 11.4.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Perform Quantitative Risk Analysis process include but are not limited to: Industry studies of similar projects, and Published material, including commercial risk databases or checklists. 11.4.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Perform Quantitative Risk Analysis process include information from similar completed projects. 11.4.2 PERFORM QUANTITATIVE RISK ANALYSIS: TOOLS AND TECHNIQUES 11.4.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Translating information on individual project risks and other sources of uncertainty into numeric inputs for the quantitative risk analysis model, Selecting the most appropriate representation of uncertainty to model particular risks or other sources of uncertainty, Modeling techniques that are appropriate in the context of the project,
  • 481.
    Identifying which toolswould be most suitable for the selected modeling techniques, and Interpreting the outputs of quantitative risk analysis. 11.4.2.2 DATA GATHERING Interviews (see Section 5.2.2.2) may be used to generate inputs for the quantitative risk analysis, drawing on inputs that include individual project risks and other sources of uncertainty. This is particularly useful where information is required from experts. The interviewer should promote an environment of trust and confidentiality during the interview to encourage honest and unbiased contributions. 11.4.2.3 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to facilitation (see Section 4.1.2.3). A skilled facilitator is useful for gathering input data during a dedicated risk workshop involving project team members and other stakeholders. Facilitated workshops can improve effectiveness by establishing a clear understanding of the purpose of the workshop, building consensus among participants, ensuring continued focus on the task, and using creative approaches to deal with interpersonal conflict or sources of bias. 11.4.2.4 REPRESENTATIONS OF UNCERTAINTY Quantitative risk analysis requires inputs to a quantitative risk analysis model that reflect individual project risks and other sources of uncertainty. Where the duration, cost, or resource requirement for a planned activity is uncertain, the range of possible values can be represented in the model as a probability distribution. This may take several forms. The most commonly used are triangular, normal, lognormal, beta, uniform, or discrete distributions. Care should be taken when selecting an appropriate probability distribution to reflect the range of possible values for the planned activity. Individual project risks may be covered by probability distributions. Alternatively, risks may be included in the model as probabilistic branches, where optional activities are added to the model to represent the time and/or cost impact of the risk should it occur, and the chance that these activities actually occur in a particular simulation run matches the risk's probability. Branches are
  • 482.
    most useful forrisks that might occur independently of any planned activity. Where risks are related, for example, with a common cause or a logical dependency, correlation is used in the model to indicate this relationship. Other sources of uncertainty may also be represented using branches to describe alternative paths through the project. 11.4.2.5 DATA ANALYSIS Data analysis techniques that can be used during this process include but are not limited to: Simulation. Quantitative risk analysis uses a model that simulates the combined effects of individual project risks and other sources of uncertainty to evaluate their potential impact on achieving project objectives. Simulations are typically performed using a Monte Carlo analysis. When running a Monte Carlo analysis for cost risk, the simulation uses the project cost estimates. When running a Monte Carlo analysis for schedule risk, the schedule network diagram and duration estimates are used. An integrated quantitative cost-schedule risk analysis uses both inputs. The output is a quantitative risk analysis model. Computer software is used to iterate the quantitative risk analysis model several thousand times. The input values (e.g., cost estimates, duration estimates, or occurrence of probabilistic branches) are chosen at random for each iteration. Outputs represent the range of possible outcomes for the project (e.g., project end date, project cost at completion). Typical outputs include a histogram presenting the number of iterations where a particular outcome resulted from the simulation, or a cumulative probability distribution (S-curve) representing the probability of achieving any particular outcome or less. An example S-curve from a Monte Carlo cost risk analysis is shown in Figure 11-13.
  • 483.
    For a quantitativeschedule risk analysis, it is also possible to conduct a criticality analysis that determines which elements of the risk model have the greatest effect on the project critical path. A criticality index is calculated for each element in the risk model, which gives the frequency with which that element appears on the critical path during the simulation, usually expressed as a percentage. The output from a criticality analysis allows the project team to focus risk response planning efforts on those activities with the highest potential effect on the overall schedule performance of the project. Sensitivity analysis. Sensitivity analysis helps to determine which individual project risks or other sources of uncertainty have the most potential impact on project outcomes. It correlates variations in project outcomes with variations in elements of the quantitative risk analysis model. One typical display of sensitivity analysis is the tornado diagram, which presents the calculated correlation coefficient for each element of the quantitative risk analysis model that can influence the project outcome. This can include individual project risks, project activities with high degrees of variability, or specific sources of ambiguity. Items are ordered
  • 484.
    by descending strengthof correlation, giving the typical tornado appearance. An example tornado diagram is shown in Figure 11-14. Decision tree analysis. Decision trees are used to support selection of the best of several alternative courses of action. Alternative paths through the project are shown in the decision tree using branches representing different decisions or events, each of which can have associated costs and related individual project risks (including both threats and opportunities). The end-points of branches in the decision tree represent the outcome from following that particular path, which can be negative or positive. The decision tree is evaluated by calculating the expected monetary value of each branch, allowing the optimal path to be selected. An example decision tree is shown in Figure 11-15.
  • 485.
    Influence diagrams. Influencediagrams are graphical aids to decision making under uncertainty. An influence diagram represents a project or situation within the project as a set of entities, outcomes, and influences, together with the relationships and effects between them. Where an element in the influence diagram is uncertain as a result of the existence of individual project risks or other sources of uncertainty, this can be represented in the influence diagram using ranges or probability distributions. The influence diagram is then evaluated using a simulation technique, such as Monte Carlo analysis, to indicate which elements have the greatest influence on key outcomes. Outputs from an influence diagram are similar to other quantitative risk analysis methods, including S-curves and tornado diagrams. 11.4.3 PERFORM QUANTITATIVE RISK ANALYSIS: OUTPUTS
  • 486.
    11.4.3.1 PROJECT DOCUMENTSUPDATES Project documents that can be considered as outputs for this process include but are not limited to the risk report described in Section 11.2.3.2. The risk report will be updated to reflect the results of the quantitative risk analysis. This will typically include: Assessment of overall project risk exposure. Overall project risk is reflected in two key measures: Chances of project success, indicated by the probability that the project will achieve its key objectives (e.g., required end date or interim milestones, required cost target, etc.) given the identified individual project risks and other sources of uncertainty; and Degree of inherent variability remaining within the project at the time the analysis was conducted, indicated by the range of possible project outcomes. Detailed probabilistic analysis of the project. Key outputs from the quantitative risk analysis are presented, such as S-curves, tornado diagrams, and criticality analysis, together with a narrative interpretation of the results. Possible detailed results of a quantitative risk analysis may include: Amount of contingency reserve needed to provide a specified level of confidence; Identification of individual project risks or other sources of uncertainty that have the greatest effect on the project critical path; and Major drivers of overall project risk, with the greatest influence on uncertainty in project outcomes. Prioritized list of individual project risks. This list includes those individual project risks that pose the greatest threat or present the greatest opportunity to the project, as indicated by sensitivity analysis. Trends in quantitative risk analysis results. As the analysis is repeated at different times during the project life cycle, trends may become apparent that inform the planning of risk responses. Recommended risk responses. The risk report may present suggested responses to the level of overall project risk exposure or key individual
  • 487.
    project risks, basedon the results of the quantitative risk analysis. These recommendations will form inputs to the Plan Risk Responses process. 11.5 PLAN RISK RESPONSES Plan Risk Responses is the process of developing options, selecting strategies, and agreeing on actions to address overall project risk exposure, as well as to treat individual project risks. The key benefit of this process is that it identifies appropriate ways to address overall project risk and individual project risks. This process also allocates resources and inserts activities into project documents and the project management plan as needed. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-16. Figure 11-17 depicts the data flow diagram for the process.
  • 488.
    Effective and appropriaterisk responses can minimize individual threats, maximize individual opportunities, and reduce overall project risk exposure. Unsuitable risk responses can have the converse effect. Once risks have been identified, analyzed, and prioritized, plans should be developed by the nominated risk owner for addressing every individual project risk the project team considers to be sufficiently important, either because of the threat it poses to the project objectives or the opportunity it offers. The project manager should also consider how to respond appropriately to the current level of overall project risk. Risk responses should be appropriate for the significance of the risk, cost- effective in meeting the challenge, realistic within the project context, agreed upon by all parties involved, and owned by a responsible person. Selecting the optimal risk response from several options is often required. The strategy or mix of strategies most likely to be effective should be selected for each risk. Structured decision-making techniques may be used to choose the most appropriate response. For large or complex projects, it may be appropriate to use a mathematical optimization model or real options analysis as a basis for a more
  • 489.
    robust economic analysisof alternative risk response strategies. Specific actions are developed to implement the agreed-upon risk response strategy, including primary and backup strategies, as necessary. A contingency plan (or fallback plan) can be developed for implementation if the selected strategy turns out not to be fully effective or if an accepted risk occurs. Secondary risks should also be identified. Secondary risks are risks that arise as a direct result of implementing a risk response. A contingency reserve is often allocated for time or cost. If developed, it may include identification of the conditions that trigger its use. 11.5.1 PLAN RISK RESPONSES: INPUTS 11.5.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan is used to help determine how resources allocated to agreed-upon risk responses will be coordinated with other project resources. Risk management plan. Described in Section 11.1.3.1. Risk management roles and responsibilities and risk thresholds are used in this process. Cost baseline. Described in Section 7.3.3.1. The cost baseline has information on the contingency fund that is allocated to respond to risks. 11.5.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned about effective risk responses used in earlier phases of the project are reviewed to determine if similar responses might be useful during the remainder of the project. Project schedule. Described in Section 6.5.3.2. The schedule is used to
  • 490.
    determine how agreed-uponrisk responses will be scheduled alongside other project activities. Project team assignments. Described in Section 9.3.3.2. Project team assignments can show the resources that can be allocated to agreed- upon risk responses. Resource calendars. Described in Section 9.2.1.2. Resource calendars identify when potential resources are available to be allocated to agreed-upon risk responses. Risk register. Described in Section 11.2.3.1. The risk register contains details of individual project risks that have been identified and prioritized, and for which risk responses are required. The priority level for each risk can help to guide the selection of appropriate risk responses. For example, high-priority threats or opportunities may require priority action and highly proactive response strategies. Threats and opportunities in the low-priority zone may not require proactive management action beyond being placed in the risk register as part of the watch list or adding a contingency reserve. The risk register identifies the nominated risk owner for each risk. It may also contain preliminary risk responses identified earlier in the Project Risk Management process. The risk register may provide other data on identified risks that can assist in planning risk responses, including root causes, risk triggers and warning signs, risks requiring responses in the near term, and risks where a need for additional analysis has been identified. Risk report. Described in Section 11.2.3.2. The risk report presents the current level of overall risk exposure of the project that will inform selection of the risk response strategy. The risk report may also list individual project risks in priority order and provide additional analysis of the distribution of individual project risks that may inform risk response selection. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register identifies potential owners for risk responses. 11.5.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Risk Responses process include but are not limited to the risk appetite and thresholds of key stakeholders.
  • 491.
    11.5.1.4 ORGANIZATIONAL PROCESSASSETS The organizational process assets that can influence the Plan Risk Responses process include but are not limited to: Templates for the risk management plan, risk register, and risk report; Historical databases; and Lessons learned repositories from similar projects. 11.5.2 PLAN RISK RESPONSES: TOOLS AND TECHNIQUES 11.5.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge in the following topics: Threat response strategies, Opportunity response strategies, Contingent response strategies, and Overall project risk response strategies. Expert input may be sought from individuals with particular subject matter expertise relevant to a specific individual project risk, for example, where specialist technical knowledge is required. 11.5.2.2 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to interviews (see Section 5.2.2.2). Development of responses to individual project risks and overall project risk may be undertaken during structured or semi-structured interviews (see Section 5.2.2.2) with risk owners. Other stakeholders may also be interviewed if necessary. The interviewer should promote an environment of trust and confidentiality in the interview setting to encourage honest and unbiased decisions. 11.5.2.3 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process includes but are not limited to facilitation (see Section 4.1.2.3). The use of facilitation improves the effectiveness of developing responses to individual project risks and overall
  • 492.
    project risk. Askilled facilitator can help risk owners understand the risk, identify and compare alternative possible risk response strategies, choose an appropriate response strategy, and identify and overcome sources of bias. 11.5.2.4 STRATEGIES FOR THREATS Five alternative strategies may be considered for dealing with threats, as follows: Escalate. Escalation is appropriate when the project team or the project sponsor agrees that a threat is outside the scope of the project or that the proposed response would exceed the project manager's authority. Escalated risks are managed at the program level, portfolio level, or other relevant part of the organization, and not on the project level. The project manager determines who should be notified about the threat and communicates the details to that person or part of the organization. It is important that ownership of escalated threats is accepted by the relevant party in the organization. Threats are usually escalated to the level that matches the objectives that would be affected if the threat occurred. Escalated threats are not monitored further by the project team after escalation, although they may be recorded in the risk register for information. Avoid. Risk avoidance is when the project team acts to eliminate the threat or protect the project from its impact. It may be appropriate for high-priority threats with a high probability of occurrence and a large negative impact. Avoidance may involve changing some aspect of the project management plan or changing the objective that is in jeopardy in order to eliminate the threat entirely, reducing its probability of occurrence to zero. The risk owner may also take action to isolate the project objectives from the risk's impact if it were to occur. Examples of avoidance actions may include removing the cause of a threat, extending the schedule, changing the project strategy, or reducing scope. Some risks can be avoided by clarifying requirements, obtaining information, improving communication, or acquiring expertise. Transfer. Transfer involves shifting ownership of a threat to a third party to manage the risk and to bear the impact if the threat occurs. Risk transfer often involves payment of a risk premium to the party taking on the threat. Transfer can be achieved by a range of actions,
  • 493.
    which include butare not limited to the use of insurance, performance bonds, warranties, guarantees, etc. Agreements may be used to transfer ownership and liability for specified risks to another party. Mitigate. In risk mitigation, action is taken to reduce the probability of occurrence and/or impact of a threat. Early mitigation action is often more effective than trying to repair the damage after the threat has occurred. Adopting less complex processes, conducting more tests, or choosing a more stable seller are examples of mitigation actions. Mitigation may involve prototype development (see Section 5.2.2.8) to reduce the risk of scaling up from a bench-scale model of a process or product. Where it is not possible to reduce probability, a mitigation response might reduce the impact by targeting factors that drive the severity. For example, designing redundancy into a system may reduce the impact from a failure of the original component. Accept. Risk acceptance acknowledges the existence of a threat, but no proactive action is taken. This strategy may be appropriate for low- priority threats, and it may also be adopted where it is not possible or cost-effective to address a threat in any other way. Acceptance can be either active or passive. The most common active acceptance strategy is to establish a contingency reserve, including amounts of time, money, or resources to handle the threat if it occurs. Passive acceptance involves no proactive action apart from periodic review of the threat to ensure that it does not change significantly. 11.5.2.5 STRATEGIES FOR OPPORTUNITIES Five alternative strategies may be considered for dealing with opportunities, as follows: Escalate. This risk response strategy is appropriate when the project team or the project sponsor agrees that an opportunity is outside the scope of the project or that the proposed response would exceed the project manager's authority. Escalated opportunities are managed at the program level, portfolio level, or other relevant part of the organization, and not on the project level. The project manager determines who should be notified about the opportunity and communicates the details to that person or part of the organization. It is important that ownership of escalated opportunities is accepted by the relevant party in the organization. Opportunities are usually
  • 494.
    escalated to thelevel that matches the objectives that would be affected if the opportunity occurred. Escalated opportunities are not monitored further by the project team after escalation, although they may be recorded in the risk register for information. Exploit. The exploit strategy may be selected for high-priority opportunities where the organization wants to ensure that the opportunity is realized. This strategy seeks to capture the benefit associated with a particular opportunity by ensuring that it definitely happens, increasing the probability of occurrence to 100%. Examples of exploiting responses may include assigning an organization's most talented resources to the project to reduce the time to completion, or using new technologies or technology upgrades to reduce cost and duration. Share. Sharing involves transferring ownership of an opportunity to a third party so that it shares some of the benefit if the opportunity occurs. It is important to select the new owner of a shared opportunity carefully so they are best able to capture the opportunity for the benefit of the project. Risk sharing often involves payment of a risk premium to the party taking on the opportunity. Examples of sharing actions include forming risk-sharing partnerships, teams, special-purpose companies, or joint ventures. Enhance. The enhance strategy is used to increase the probability and/or impact of an opportunity. Early enhancement action is often more effective than trying to improve the benefit after the opportunity has occurred. The probability of occurrence of an opportunity may be increased by focusing attention on its causes. Where it is not possible to increase probability, an enhancement response might increase the impact by targeting factors that drive the size of the potential benefit. Examples of enhancing opportunities include adding more resources to an activity to finish early. Accept. Accepting an opportunity acknowledges its existence but no proactive action is taken. This strategy may be appropriate for low- priority opportunities, and it may also be adopted where it is not possible or cost-effective to address an opportunity in any other way. Acceptance can be either active or passive. The most common active acceptance strategy is to establish a contingency reserve, including amounts of time, money, or resources to take advantage of the
  • 495.
    opportunity if itoccurs. Passive acceptance involves no proactive action apart from periodic review of the opportunity to ensure that it does not change significantly. 11.5.2.6 CONTINGENT RESPONSE STRATEGIES Some responses are designed for use only if certain events occur. For some risks, it is appropriate for the project team to make a response plan that will only be executed under certain predefined conditions, if it is believed that there will be sufficient warning to implement the plan. Events that trigger the contingency response, such as missing intermediate milestones or gaining higher priority with a seller, should be defined and tracked. Risk responses identified using this technique are often called contingency plans or fallback plans and include identified triggering events that set the plans in effect. 11.5.2.7 STRATEGIES FOR OVERALL PROJECT RISK Risk responses should be planned and implemented not only for individual project risks but also to address overall project risk. The same risk response strategies that are used to deal with individual project risks can also be applied to overall project risk: Avoid. Where the level of overall project risk is significantly negative and outside the agreed-upon risk thresholds for the project, an avoid strategy may be adopted. This involves taking focused action to reduce the negative effect of uncertainty on the project as a whole and bring the project back within the thresholds. An example of avoidance at the overall project level would include removal of high-risk elements of scope from the project. Where it is not possible to bring the project back within the thresholds, the project may be canceled. This represents the most extreme degree of risk avoidance and it should be used only if the overall level of threat is, and will remain, unacceptable. Exploit. Where the level of overall project risk is significantly positive and outside the agreed-upon risk thresholds for the project, an exploit strategy may be adopted. This involves taking focused action to capture the positive effect of uncertainty on the project as a whole. An example of exploiting at the overall project level would include addition of high-benefit elements of scope to the project to add value or benefits to stakeholders. Alternatively the risk thresholds for the
  • 496.
    project may bemodified with the agreement of key stakeholders in order to embrace the opportunity. Transfer/share. If the level of overall project risk is high but the organization is unable to address it effectively, a third party may be involved to manage the risk on behalf of the organization. Where overall project risk is negative, a transfer strategy is required, which may involve payment of a risk premium. In the case of high positive overall project risk, ownership may be shared in order to reap the associated benefits. Examples of both transfer and share strategies for overall project risk include but are not limited to setting up a collaborative business structure in which the buyer and the seller share the overall project risk, launching a joint venture or special-purpose company, or subcontracting key elements of the project. Mitigate/enhance. These strategies involve changing the level of overall project risk to optimize the chances of achieving the project's objectives. The mitigation strategy is used where overall project risk is negative, and enhancement applies when it is positive. Examples of mitigation or enhancement strategies include replanning the project, changing the scope and boundaries of the project, modifying project priority, changing resource allocations, adjusting delivery times, etc. Accept. Where no proactive risk response strategy is possible to address overall project risk, the organization may choose to continue with the project as currently defined, even if overall project risk is outside the agreed-upon thresholds. Acceptance can be either active or passive. The most common active acceptance strategy is to establish an overall contingency reserve for the project, including amounts of time, money, or resources to be used if the project exceeds its thresholds. Passive acceptance involves no proactive action apart from periodic review of the level of overall project risk to ensure that it does not change significantly. 11.5.2.8 DATA ANALYSIS A number of alternative risk response strategies may be considered. Data analysis techniques that can be used to select a preferred risk response strategy include but are not limited to: Alternatives analysis. A simple comparison of the characteristics and requirements of alternative risk response options can lead to a decision
  • 497.
    on which responseis most appropriate. Cost-benefit analysis. If the impact of an individual project risk can be quantified in monetary terms, then the cost-effectiveness of alternative risk response strategies can be determined using cost-benefit analysis (see Section 8.1.2.3). The ratio of (change in impact level) divided by (implementation cost) gives the cost effectiveness of the response strategy, with a higher ratio indicating a more effective response. 11.5.2.9 DECISION MAKING Decision-making techniques that can be used to select a risk response strategy include but are not limited to multicriteria decision analysis (described in Section 8.1.2.4). One or more risk response strategies may be under consideration. Decision-making techniques can help prioritize risk response strategies. Multicriteria decision analysis uses a decision matrix to provide a systematic approach for establishing key decision criteria, evaluating and ranking alternatives, and selecting a preferred option. Criteria for risk response selection may include but are not limited to cost of response, likely effectiveness of response in changing probability and/or impact, resource availability, timing constraints (urgency, proximity, and dormancy), level of impact if the risk occurs, effect of response on related risks, introduction of secondary risks, etc. Different strategies may be selected later in the project if the original choice proves to be ineffective. 11.5.3 PLAN RISK RESPONSES: OUTPUTS 11.5.3.1 CHANGE REQUESTS Described in Section 4.3.3.4. Planned risk responses may result in a change request to the cost and schedule baselines or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 11.5.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to:
  • 498.
    Schedule management plan.Described in Section 6.1.3.1. Changes to the schedule management plan, such as changes to resource loading and leveling, or updates to the schedule strategy, are incorporated. Cost management plan. Described in Section 7.1.3.1. Changes to the cost management plan, such as changes to cost accounting, tracking, and reports, as well as updates to the budget strategy and how contingency reserves are consumed, are incorporated. Quality management plan. Described in Section 8.1.3.1. Changes to the quality management plan, such as changes to approaches for meeting requirements, quality management approaches, or quality control processes, are incorporated. Resource management plan. Described in Section 9.1.3.1. Changes to the resource management plan, such as changes to resource allocation, as well as updates to the resource strategy, are incorporated. Procurement management plan. Described in Section 12.1.3.1. Changes to the procurement management plan, such as alterations in the make-or-buy decision or contract type(s), are incorporated. Scope baseline. Described in Section 5.4.3.1. Changes in the scope baseline are incorporated in response to approved changes in scope that may arise from agreed-upon risk responses. Schedule baseline. Described in Section 6.5.3.1. Changes in the schedule baseline are incorporated in response to approved changes in schedule estimates that may arise from agreed-upon risk responses. Cost baseline. Described in Section 7.3.3.1. Changes in the cost baseline are incorporated in response to approved changes in cost estimates that may arise from agreed-upon risk responses. 11.5.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. During the Plan Risk Responses process, new assumptions may be made, new constraints may be identified, and existing assumptions or constraints may be revisited and changed. The assumption log should be updated with this new information.
  • 499.
    Cost forecasts. Describedin Section 7.4.3.2. Cost forecasts may change as a result of planned risk responses. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information about risk responses that may be useful for future phases of the project or future projects. Project schedule. Described in Section 6.5.3.2. Activities relating to agreed-upon risk responses may be added to the project schedule. Project team assignments. Described in Section 9.3.3.2. Once the responses are confirmed, the necessary resources should be allocated to each action associated with a risk response plan. These resources include suitably qualified and experienced personnel to execute the agreed-upon action (usually within the project team) a specific budget and time allowance for the action, and any required technical resources to complete the action. Risk register. Described in Section 11.2.3.1. The risk register is updated when appropriate risk responses are chosen and agreed upon. Updates to the risk register may include but are not limited to: Agreed-upon response strategies; Specific actions to implement the chosen response strategy; Trigger conditions, symptoms, and warning signs of a risk occurrence; Budget and schedule activities required to implement the chosen responses; Contingency plans and risk triggers that call for their execution; Fallback plans for use when a risk that has occurred and the primary response proves to be inadequate; Residual risks that are expected to remain after planned responses have been taken, as well as those that have been deliberately accepted; and Secondary risks that arise as a direct outcome of implementing a risk response. Risk report. Described in Section 11.2.3.2. The risk report may be updated to present agreed-upon responses to the current overall project risk exposure and high-priority risks, together with the expected
  • 500.
    changes that maybe expected as a result of implementing these responses. 11.6 IMPLEMENT RISK RESPONSES Implement Risk Responses is the process of implementing agreed-upon risk response plans. The key benefit of this process is that it ensures that agreed-upon risk responses are executed as planned in order to address overall project risk exposure, minimize individual project threats, and maximize individual project opportunities. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-18. Figure 11-19 depicts the data flow diagram for the process.
  • 501.
    Proper attention tothe Implement Risk Responses process will ensure that agreed-upon risk responses are actually executed. A common problem with Project Risk Management is that project teams spend effort in identifying and analyzing risks and developing risk responses, then risk responses are agreed upon and documented in the risk register and risk report, but no action is taken to manage the risk. Only if risk owners give the required level of effort to implementing the agreed-upon responses will the overall risk exposure of the project and individual threats and opportunities be managed proactively. 11.6.1 IMPLEMENT RISK RESPONSES: INPUTS 11.6.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the risk management plan. Described in Section 11.1.3.1, the risk management plan lists the roles and responsibilities of project team members and other stakeholders for risk management. This information is used when allocating owners for agreed-upon risk responses. The risk management plan also defines the level of detail for the risk management methodology for the project. It also specifies risk thresholds for the project based on the risk appetite of key stakeholders, which define the acceptable target that the implementation of risk responses is required to achieve. 11.6.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to implementing risk responses can be applied to later phases in the project to improve the effectiveness of this process. Risk register. Described in Section 11.2.3.1. The risk register records the agreed-upon risk responses for each individual risk and the nominated owners for each response plan. Risk report. Described in Section 11.2.3.2. The risk report includes an assessment of the current overall project risk exposure, as well as the
  • 502.
    agreed-upon risk responsestrategy. It also describes the major individual project risks with their planned responses. 11.6.1.3 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Implement Risk Responses process include but are not limited to the lessons learned repository from similar completed projects that indicate the effectiveness of particular risk responses. 11.6.2 IMPLEMENT RISK RESPONSES: TOOLS AND TECHNIQUES 11.6.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge to validate or modify risk responses if necessary, and decide how to implement them in the most efficient and effective manner. 11.6.2.2 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to influencing. Some risk response actions may be owned by people outside the immediate project team or who have other competing demands. The project manager or person responsible for facilitating the risk process may need to exercise influencing (see Section 9.5.2.1) to encourage nominated risk owners to take necessary action where required. 11.6.2.3 PROJECT MANAGEMENT INFORMATION SYSTEM (PMIS) Described in Section 4.3.2.2. Project management information systems can include schedule, resource, and cost software to ensure that agreed-upon risk response plans and their associated activities are integrated into the project alongside other project activities. 11.6.3 IMPLEMENT RISK RESPONSES: OUTPUTS
  • 503.
    11.6.3.1 CHANGE REQUESTS Describedin Section 4.3.3.4. Implementation of risk responses may result in a change request to the cost and schedule baselines or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 11.6.3.2 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. Where issues are identified as part of the Implement Risk Responses process, they are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered when implementing risk responses and how they could have been avoided, as well as approaches that worked well for implementing risk responses. Project team assignments. Described in Section 9.3.3.2. Once the risk responses are confirmed, the necessary resources should be allocated to each action associated with a risk response plan. These resources include suitably qualified and experienced personnel to execute the agreed-upon action (usually within the project team), a specific budget and time allowance for the action, and any required technical resources to complete the action. Risk register. Described in Section 11.2.3.1. The risk register may be updated to reflect any changes to the previously agreed-upon risk responses for individual project risks that are subsequently made as a result of the Implement Risk Responses process. Risk report. Described in Section 11.2.3.2. The risk report may be updated to reflect any changes to the previously agreed-upon risk response to overall project risk exposure that are subsequently made as a result of the Implement Risk Responses process. 11.7 MONITOR RISKS
  • 504.
    Monitor Risks isthe process of monitoring the implementation of agreed-upon risk response plans, tracking identified risks, identifying and analyzing new risks, and evaluating risk process effectiveness throughout the project. The key benefit of this process is that it enables project decisions to be based on current information about overall project risk exposure and individual project risks. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 11-20. Figure 11-21 depicts the data flow diagram for the process.
  • 505.
    In order toensure that the project team and key stakeholders are aware of the current level of risk exposure, project work should be continuously monitored for new, changing, and outdated individual project risks and for changes in the level of overall project risk by applying the Monitor Risks process. The Monitor Risks process uses performance information generated during project execution to determine if: Implemented risk responses are effective, Level of overall project risk has changed, Status of identified individual project risks has changed, New individual project risks have arisen, Risk management approach is still appropriate, Project assumptions are still valid, Risk management policies and procedures are being followed, Contingency reserves for cost or schedule require modification, and
  • 506.
    Project strategy isstill valid. 11.7.1 MONITOR RISKS: INPUTS 11.7.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to the risk management plan. Described in Section 11.3.1.1. The risk management plan provides guidance on how and when risks should be reviewed, which policies and procedures should be followed, the roles and responsibilities in the monitoring process, and reporting formats. 11.7.1.2 PROJECT DOCUMENTS Project documents that should be considered as inputs for this process include but are not limited to: Issue log. Described in Section 4.3.3.3. The issue log is used to see if any of the open issues have been updated and necessitate an update to the risk register. Lessons learned register. Described in Section 4.4.3.1. Risk-related lessons from earlier in the project can be applied to later phases in the project. Risk register. Described in Section 11.2.3.1. The risk register has key inputs that include identified individual project risks, risk owners, agreed-upon risk responses, and specific implementation actions. It may also provide other details including control actions for assessing the effectiveness of response plans, symptoms and warning signs of risk, residual and secondary risks, and a watch list of low-priority risks. Risk report. Described in Section 11.2.3.2. The risk report includes an assessment of the current overall project risk exposure as well as the agreed-upon risk response strategy. It also describes the major individual risks with planned responses and risk owners. 11.7.1.3 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on project
  • 507.
    status such asrisk responses that have been implemented, risks that have occurred, risks that are active and those that have been closed out. 11.7.1.4 WORK PERFORMANCE REPORTS Described in Section 4.5.3.1. Work performance reports provide information from performance measurements that can be analyzed to provide project work performance information including variance analysis, earned value data, and forecasting data. This information could be relevant when monitoring performance-related risks. 11.7.2 MONITOR RISKS: TOOLS AND TECHNIQUES 11.7.2.1 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Technical performance analysis. Technical performance analysis compares technical accomplishments during project execution to the schedule of technical achievement. It requires the definition of objective, quantifiable measures of technical performance, which can be used to compare actual results against targets. Such technical performance measures may include weight, transaction times, number of delivered defects, storage capacity, etc. Deviation can indicate the potential impact of threats or opportunities. Reserve analysis. Described in Section 7.2.2.6. Throughout execution of the project, some individual project risks may occur with positive or negative impacts on budget or schedule contingency reserves. Reserve analysis compares the amount of the contingency reserves remaining to the amount of risk remaining at any time in the project in order to determine if the remaining reserve is adequate. This may be communicated using various graphical representations, including a burndown chart. 11.7.2.2 AUDITS Described in Section 8.2.2.5. Risk audits are a type of audit that may be used to consider the effectiveness of the risk management process. The project
  • 508.
    manager is responsiblefor ensuring that risk audits are performed at an appropriate frequency, as defined in the project's risk management plan. Risk audits may be included during routine project review meetings or may form part of a risk review meeting, or the team may choose to hold separate risk audit meetings. The format for the risk audit and its objectives should be clearly defined before the audit is conducted. 11.7.2.3 MEETINGS Meetings that can be used during this process include but are not limited to risk reviews. Risk reviews are scheduled regularly and should examine and document the effectiveness of risk responses in dealing with overall project risk and with identified individual project risks. Risk reviews may also result in identification of new individual project risks, (including secondary risks that arise from agreed-upon risk responses), reassessment of current risks, the closing of risks that are outdated, issues that have arisen as the result of risks that have occurred, and identification of lessons to be learned for implementation in ongoing phases in the current project or in similar projects in the future. The risk review may be conducted as part of a periodic project status meeting or a dedicated risk review meeting may be held, as specified in the risk management plan. 11.7.3 MONITOR RISKS: OUTPUTS 11.7.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how project risk management is performing by comparing the individual risks that have occurred with the expectation of how they would occur. This information indicates the effectiveness of the response planning and response implementation processes. 11.7.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. The Monitor Risks process may result in a change request to the cost and schedule baselines or other components of the project management plan. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6).
  • 509.
    Change requests caninclude recommended corrective and preventive actions to address the current level of overall project risk or to address individual project risks. 11.7.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. This may affect any component of the project management plan. 11.7.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. During the Monitor Risks process, new assumptions may be made, new constraints may be identified, and existing assumptions or constraints may be revisited and changed. The assumption log is updated with this new information. Issue log. Described in Section 4.3.3.3. Where issues are identified as part of the Monitor Risks process, these are recorded in the issue log. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with any risk-related lessons learned during risk reviews so these can be used on later phases of the project or in future projects. Risk register. Described in Section 11.2.3.1. The risk register is updated with information on individual project risks generated during the Monitor Risks process. This may include adding new risks, updating outdated risks or risks that were realized, updating risk responses, and so forth. Risk report. Described in Section 11.2.3.2. As new information becomes available through the Monitor Risks process, the risk report is updated to reflect the current status of major individual project risks and the current level of overall project risk. The risk report may also include details of the top individual project risks, agreed-upon responses and owners, and conclusions and recommendations. It may also include conclusions from risk audits on the effectiveness of the risk management process.
  • 510.
    11.7.3.5 ORGANIZATIONAL PROCESSASSETS UPDATES Organizational process assets that are updated as a result of the Monitor Risks process include but are not limited to: Templates for the risk management plan, risk register, and risk report; and Risk breakdown structure.
  • 511.
    12 PROJECT PROCUREMENT MANAGEMENT ProjectProcurement Management includes the processes necessary to purchase or acquire products, services, or results needed from outside the project team. Project Procurement Management includes the management and control processes required to develop and administer agreements such as contracts, purchase orders, memoranda of agreements (MOAs), or internal service level agreements (SLAs). The personnel authorized to procure the goods and/or services required for the project may be members of the project team, management, or part of the organization's purchasing department if applicable. Project Procurement Management processes include the following: 12.1 Plan Procurement Management—The process of documenting project procurement decisions, specifying the approach, and identifying potential sellers. 12.2 Conduct Procurements—The process of obtaining seller responses, selecting a seller, and awarding a contract. 12.3 Control Procurements—The process of managing procurement relationships, monitoring contract performance, making changes and corrections as appropriate, and closing out contracts. The procurement processes are presented as discrete processes with defined interfaces. In practice, procurement processes can be complex and can interact with each other and with processes in other Knowledge Areas in ways that cannot be completely detailed in the PMBOK® Guide. The processes described in this section are written from the viewpoint where goods or services are obtained from outside of the project. Figure 12-1 provides an overview of the Project Procurement Management processes. The Project Procurement Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 512.
    KEY CONCEPTS FORPROJECT PROCUREMENT MANAGEMENT More than most other project management processes, there can be significant legal obligations and penalties tied to the procurement process. The project manager does not have to be a trained expert in procurement management laws and regulations but should be familiar enough with the procurement process to make intelligent decisions regarding contracts and contractual relationships. The project manager is typically not authorized to sign legal agreements binding the organization; this is reserved for those who have the authority to do so. The Project Procurement Management processes involve agreements that describe the relationship between two parties—a buyer and a seller. Agreements can be as simple as the purchase of a defined quantity of labor hours at a specified labor rate, or they can be as complex as multiyear international construction contracts. The contracting approach and the contract itself should reflect the simplicity or complexity of the deliverables or required effort and should be written in a manner that complies with local, national, and international laws regarding contracts.
  • 513.
    A contract shouldclearly state the deliverables and results expected, including any knowledge transfer from the seller to the buyer. Anything not in the contract cannot be legally enforced. When working internationally, project managers should keep in mind the effect that culture and local law have upon contracts and their enforceability, no matter how clearly a contract is written. A purchasing contract includes terms and conditions and may incorporate other buyer specifics as to what the seller is to perform or provide. It is the project management team's responsibility to make certain that all procurements meet the specific needs of the project while working with the procurement office to ensure organizational procurement policies are followed. Depending on the application area, an agreement can be a contract, an SLA, an understanding, an MOA, or a purchase order. Most organizations document policies and procedures specifically defining procurement rules and specifying who has authority to sign and administer such agreements on behalf of the organization. Across the world, organizations use different names for departments or divisions that deal with procurement, such as purchasing, contracting, procurement, or acquisitions; however, the responsibilities are likely to be similar. Although all project documents may be subject to some form of review and approval, the legally binding nature of a contract means it will be subjected to a more extensive approval process, often involving the legal department. In all cases, the primary focus of the review and approval process is to ensure that the contract adequately describes the products, services, or results that the seller is agreeing to provide, while being in compliance with the laws and regulations regarding procurements. These sections are often separate appendices or annexes, allowing standardized legal contract language to be used. A complex project may involve managing multiple contracts simultaneously or in sequence. In such cases, each contract life cycle may begin and end during any phase of the project life cycle. The buyer-seller relationship may exist at many levels on any one project, and between organizations internal to and external to the acquiring organization. Depending on the application area, the seller may be identified as a contractor, vendor, service provider, or supplier. The buyer may be the owner of the final product, a subcontractor, the acquiring organization, a service requestor, or the purchaser. The seller can be viewed during the contract life cycle first as a bidder, then as the selected source, and then as the contracted supplier or vendor. The winning bidder may manage the work as a project. In such cases:
  • 514.
    The buyer becomesthe customer to subcontractors, suppliers, and service providers and is therefore a key project stakeholder from the seller's perspective. The seller's project management team may be concerned with all the processes involved in performing the work or providing the services. Terms and conditions of the contract and the procurement statement of work (SOW) become key inputs to many of the seller's management processes. The contract can actually contain the inputs (e.g., major deliverables, key milestones, cost objectives) or it can limit the project team's options (for example, buyer approval of staffing decisions is often required on IT integration projects). The procurement SOW may have other names, such as the technical statement of work. The seller itself may become a buyer of lower-tiered products, services, and materials from subcontractors and suppliers. In this section, it is assumed that the buyer of an item for the project is assigned to the project team and/or is part of the larger organization. The seller is assumed to be providing services and/or materials to the project and is usually outside the performing organization. For some projects, the seller role may be filled by a group or function that is part of the performing organization but external to the project. For larger, more complex projects, the seller may become part of an integrated project team after the contract is awarded. For smaller organizations or startup companies and those without a purchasing, contracting, or procurement department, the project manager may assume the purchasing authority role to negotiate and sign contracts directly (decentralized purchasing). For more mature organizations, the actual procurement and contracting functions will be carried out by a separate department with the specific role to purchase, negotiate, and sign contracts (centralized purchasing). In international contracting, the legal jurisdictions under which the contracts will be administered are clearly spelled out in the contract. In most cases, the seller is an external contractor who is bound by a formal contractual relationship. TRENDS AND EMERGING PRACTICES IN PROCUREMENT MANAGEMENT There are a number of major trends in software tools, risk, processes, logistics, and technology with different industries that can affect the success rate of
  • 515.
    projects. Trends andemerging practices for Project Procurement Management include but are not limited to: Advances in tools. There has been significant improvement in the development of tools to manage the procurement and implementation phases of a project. Online tools for procurement now give the buyers a single point where procurements can be advertised and provide sellers with a single source to find procurement documents and complete them directly online. In the construction/engineering/infrastructure field, the increasing use of the building information model (BIM) in software tools has been shown to save significant amounts of time and money on projects using it. This approach can substantially reduce construction claims, thereby reducing both costs and schedule. Major companies and governments worldwide are beginning to mandate the use of BIM on large projects. More advanced risk management. An increasing trend in risk management is to write contracts that accurately allocate specific risks to those entities most capable of managing them. No contractor is capable of managing all the possible major risks on a project. The buyer will be required to accept the risks that the contractors do not have control over, such as changing corporate policies in the buying organization, changing regulatory requirements, and other risks from outside the project. Contracts may specify that risk management be performed as part of the contract. Changing contracting processes. There has been a significant growth in megaprojects in the past several years, particularly in the areas of infrastructure development and engineering projects. Multibillion- dollar projects are now common. A large proportion of these involve international contracts with multiple contractors from many countries and are inherently more risky than projects using only local contractors. Increasingly, the contractor works closely with the client in the procurement process to take advantage of discounts through quantity purchases or other special considerations. For these projects, the use of internationally recognized standard contract forms is increasing in order to reduce problems and claims during execution. Logistics and supply chain management. Because so many large engineering, construction infrastructure projects are done through multiple international contractors, the management of the flow of
  • 516.
    materials becomes criticalto successful completion. For long-lead items, both the manufacture of the items and their transportation to the project site become schedule-drivers. In the IT field, a long-lead item may require ordering 2 to 3 months in advance. In complex construction projects, long-lead items may require ordering 1 to 2 years in advance or longer. For these projects, long-lead items may be procured in advance of other procurement contracts to meet the planned project completion date. It is possible to begin contracting for these long-lead materials, supplies, or equipment before the final design of the end product itself is completed based on the known requirements identified in the top-level design. The management of the supply chain is an area of increasing emphasis by the contractor's project team. Not only are primary sources of supplies identified early in the project, but secondary, back-up sources are also generally identified. Many countries around the world require international contractors to purchase certain minimum percentages of material and supplies from local vendors. Technology and stakeholder relations. Publicly funded projects are under increasing scrutiny. A trend in infrastructure and commercial construction projects is the use of technology including web cameras (webcams) to improve stakeholder communications and relations. During construction, one or more webcams are installed on the site, with periodic updates to a publicly available website. The progress on the project can be viewed on the Internet by all stakeholders. Video data can also be stored, allowing analysis if a claim arises. Some projects have discovered that the use of webcams minimizes disputes relating to the construction work on site, as the webcam has recorded the events, so there should be no disagreement about the facts of the matter. Trial engagements. Not every seller is well suited for an organization's environment. Therefore, some projects will engage several candidate sellers for initial deliverables and work products on a paid basis before making the full commitment to a larger portion of the project scope. This accelerates momentum by allowing the buyer to evaluate potential partners, while simultaneously making progress on project work. TAILORING CONSIDERATIONS
  • 517.
    Because each projectis unique, the project manager may need to tailor the way that Project Procurement Management processes are applied. Considerations for tailoring include but are not limited to: Complexity of procurement. Is there one main procurement or are there multiple procurements at different times with different sellers that add to the complexity of the procurements? Physical location. Are the buyers and sellers in the same location, or reasonably close, or in different time zones, countries, or continents? Governance and regulatory environment. Are local laws and regulations regarding procurement activities integrated with the organization's procurement policies? How does this affect contract auditing requirements? Availability of contractors. Are there available contractors who are capable of performing the work? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS In agile environments, specific sellers may be used to extend the team. This collaborative working relationship can lead to a shared risk procurement model where both the buyer and the seller share in the risk and rewards associated with a project. Larger projects may use an adaptive approach for some deliverables and a more stable approach for other parts. In these cases, a governing agreement such as a master services agreement (MSA) may be used for the overall engagement, with the adaptive work being placed in an appendix or supplement. This allows changes to occur on the adaptive scope without impacting the overall contract. 12.1 PLAN PROCUREMENT MANAGEMENT Plan Procurement Management is the process of documenting project procurement decisions, specifying the approach and identifying potential sellers. The key benefit of this process is that it determines whether to acquire goods and services from outside the project and, if so, what to acquire as well as how and when to acquire it. Goods and services may be procured from other parts of the performing organization or from external sources. This process is performed once or at predefined points in the project. The inputs, tools and techniques, and outputs of this process are depicted in Figure 12-2. Figure 12-3 depicts the data
  • 518.
    flow diagram ofthe process.
  • 519.
    Defining roles andresponsibilities related to procurement should be done early in the Plan Procurement Management process. The project manager should ensure that the project team is staffed with procurement expertise at the level required for the project. Participants in the procurement process may include personnel from the purchasing or procurement department as well as personnel from the buying organization's legal department. These responsibilities should be documented in the procurement management plan. Typical steps might be: Prepare the procurement statement of work (SOW) or terms of reference (TOR). Prepare a high-level cost estimate to determine the budget. Advertise the opportunity.
  • 520.
    Identify a shortlist of qualified sellers. Prepare and issue bid documents. Prepare and submit proposals by the seller. Conduct a technical evaluation of the proposals including quality. Perform a cost evaluation of the proposals. Prepare the final combined quality and cost evaluation to select the winning proposal. Finalize negotiations and sign contract between the buyer and the seller. The requirements of the project schedule can significantly influence the strategy during the Plan Procurement Management process. Decisions made in developing the procurement management plan can also influence the project schedule and are integrated with the Develop Schedule process, the Estimate Activity Resources process, and make-or-buy decisions. 12.1.1 PLAN PROCUREMENT MANAGEMENT: INPUTS 12.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter contains the objectives, project description, summary milestones, and the preapproved financial resources. 12.1.1.2 BUSINESS DOCUMENTS Described in Section 1.2.6. The business documents include the following: Business case. The procurement strategy and business case need to be aligned to ensure the business case remains valid. Benefits management plan. The benefits management plan describes when specific project benefits are expected to be available, which will drive procurement dates and contract language. 12.1.1.3 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to:
  • 521.
    Scope management plan.Described in Section 5.1.3.1. The scope management plan describes how the scope of work by the contractors will be managed through the execution phase of the project. Quality management plan. Described in Section 8.1.3.1. The quality management plan contains the applicable industry standards and codes the project is required to follow. This information is used in bidding documents such as the RFP and will eventually be referenced in the contract. This information may be used in supplier prequalification or as part of the selection criteria. Resource management plan. Described in Section 9.1.3.1. The resource management plan has information on which resources will be purchased or leased, along with any assumptions or constraints that would influence the procurement. Scope baseline. Described in Section 5.4.3.1. The scope baseline contains the scope statement, WBS, and WBS dictionary. Early in the project, the project scope may still be evolving. The elements of the scope that are known are used to develop the statement of work (SOW) and the terms of reference (TOR). 12.1.1.4 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Milestone list. Described in Section 6.2.3.3. This list of major milestones show when the sellers are required to deliver their results. Project team assignments. Described in Section 9.3.3.2. The project team assignments contain information on the skills and abilities of the project team and their availability to support the procurement activities. If the project team does not have the skills to perform the procurement activities for which they are responsible, additional resources will need to be acquired or training will need to be provided, or both. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may include: Technical requirements that the seller is required to satisfy, and Requirements with contractual and legal implications that may
  • 522.
    include health, safety,security, performance, environmental, insurance, intellectual property rights, equal employment opportunity, licenses, permits, and other nontechnical requirements. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix links product requirements from their origin to the deliverables that satisfy them. Resource requirements. Described in Section 9.2.3.1. Resource requirements contain information on specific needs such as team and phyisical resources that may need to be acquired. Risk register. Described in Section 11.2.3.1. The risk register provides the list of risks, along with the results of risk analysis and risk response planning. Some risks are transferred via a procurement agreement. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register provides details on the project participants and their interests in the project, including regulatory agencies, contracting personnel, and legal personnel. 12.1.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Plan Procurement Management process include but are not limited to: Marketplace conditions; Products, services, and results that are available in the marketplace; Sellers, including their past performance or reputation; Typical terms and conditions for products, services, and results or for the specific industry; Unique local requirements, such as regulatory requirements for local labor or sellers; Legal advice regarding procurements; Contract management systems, including procedures for contract change control; Established multi-tier supplier system of prequalified sellers based on prior experience; and Financial accounting and contract payments system.
  • 523.
    12.1.1.6 ORGANIZATIONAL PROCESSASSETS The various types of contractual agreements used by the organization also influence decisions for the Plan Procurement Management process. The organizational process assets that can influence the Plan Procurement Management process include but are not limited to: Preapproved seller lists. Lists of sellers that have been properly vetted can streamline the steps needed to advertise the opportunity and shorten the timeline for the seller selection process. Formal procurement policies, procedures, and guidelines. Most organizations have formal procurement policies and buying organizations. When such procurement support is not available, the project team should supply both the resources and the expertise to perform such procurement activities. Contract types. All legal contractual relationships generally fall into one of two broad families: either fixed-price or cost-reimbursable. Also, there is a third hybrid type commonly used called the time and materials contract. The more popular contract types in use are discussed below as discrete types, but, in practice, it is not unusual to combine one or more types into a single procurement. Fixed-price contracts. This category of contracts involves setting a fixed total price for a defined product, service, or result to be provided. These contracts should be used when the requirements are well defined and no significant changes to the scope are expected. Types of fixed-price contract include: Firm fixed price (FFP). The most commonly used contract type is the FFP. It is favored by most buying organizations because the price for goods is set at the outset and not subject to change unless the scope of work changes. Fixed price incentive fee (FPIF). This fixed-price arrangement gives the buyer and seller some flexibility in that it allows for deviation from performance, with financial incentives tied to achieving agreed-upon metrics. Typically, such financial incentives are related to cost, schedule, or technical performance of the seller. Under FPIF contracts, a price ceiling is set, and all costs above the price ceiling are the responsibility of the seller.
  • 524.
    Fixed price witheconomic price adjustments (FPEPA). This type is used whenever the seller's performance period spans a considerable period of years, or if the payments are made in a different currency. It is a fixed-price contract, but with a special provision allowing for predefined final adjustments to the contract price due to changed conditions, such as inflation changes or cost increases (or decreases) for specific commodities. Cost-reimbursable contracts. This category of contract involves payments (cost reimbursements) to the seller for all legitimate actual costs incurred for completed work, plus a fee representing seller profit. This type should be used if the scope of work is expected to change significantly during the execution of the contract. Variations can include: Cost plus fixed fee (CPFF). The seller is reimbursed for all allowable costs for performing the contract work and receives a fixed-fee payment calculated as a percentage of the initial estimated project costs. Fee amounts do not change unless the project scope changes. Cost plus incentive fee (CPIF). The seller is reimbursed for all allowable costs for performing the contract work and receives a predetermined incentive fee based on achieving certain performance objectives as set forth in the contract. In CPIF contracts, if the final costs are less or greater than the original estimated costs, then both the buyer and seller share costs from the departures based upon a prenegotiated cost-sharing formula, for example, an 80/20 split over/under target costs based on the actual performance of the seller. Cost plus award fee (CPAF). The seller is reimbursed for all legitimate costs, but the majority of the fee is earned based on the satisfaction of certain broad subjective performance criteria that are defined and incorporated into the contract. The determination of fee is based solely on the subjective determination of seller performance by the buyer and is generally not subject to appeals. Time and material contracts (T&M). Time and material contracts (also called time and means) are a hybrid type of contractual arrangement with aspects of both cost-reimbursable and fixed-price contracts. They are often used for staff augmentation, acquisition of experts, and any
  • 525.
    outside support whena precise statement of work cannot be quickly prescribed. 12.1.2 PLAN PROCUREMENT MANAGEMENT: TOOLS AND TECHNIQUES 12.1.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Procurement and purchasing, Contract types and contract documents, and Regulations and compliance topics. 12.1.2.2 DATA GATHERING A data-gathering technique that can be used for this process includes but is not limited to market research. Market research includes examination of industry and specific seller capabilities. Procurement teams may leverage information gained at conferences, online reviews, and a variety of sources to identify market capabilities. The team may also refine specific procurement objectives to leverage maturing technologies while balancing risks associated with the breadth of sellers who can provide the desired materials or services. 12.1.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to make-or-buy analysis. A make-or-buy analysis is used to determine whether work or deliverables can best be accomplished by the project team or should be purchased from outside sources. Factors to consider in the make-or- buy decision include the organization's current resource allocation and their skills and abilities, the need for specialized expertise, the desire to not expand permanent employment obligations, and the need for independent expertise. It also includes evaluating the risks involved with each make-or-buy decision. Make-or-buy analysis may use payback period, return on investment (ROI), internal rate of return (IRR), discounted cash flow, net present value (NPV), benefit/cost analysis (BCA), or other techniques in order to decide whether to
  • 526.
    include something aspart of the project or purchase it externally. 12.1.2.4 SOURCE SELECTION ANALYSIS It is necessary to review the prioritization of the competing demands for the project before deciding on the selection method. Since competitive selection methods may require sellers to invest a large amount of time and resources upfront, it is a good practice to include the evaluation method in the procurement documents so bidders know how they will be evaluated. Commonly used selection methods include the following: Least cost. The least cost method may be appropriate for procurements of a standard or routine nature where well-established practices and standards exist and from which a specific and well-defined outcome is expected, which can be executed at different costs. Qualifications only. The qualifications only selection method applies when the time and cost of a full selection process would not make sense because the value of the procurement is relatively small. The buyer establishes a short list and selects the bidder with the best credibility, qualifications, experience, expertise, areas of specialization, and references. Quality-based/highest technical proposal score. The selected firm is asked to submit a proposal with both technical and cost details and is then invited to negotiate the contract if the technical proposal proves acceptable. Using this method, technical proposals are first evaluated based on the quality of the technical solution offered. The seller who submitted the highest-ranked technical proposal is selected if their financial proposal can be negotiated and accepted. Quality and cost-based. The quality and cost-based method allows cost to be included as a factor in the seller selection process. In general, when risk and/or uncertainty are greater for the project, quality should be a key element when compared to cost. Sole source. The buyer asks a specific seller to prepare technical and financial proposals, which are then negotiated. Since there is no competition, this method is acceptable only when properly justified and should be viewed as an exception. Fixed budget. The fixed-budget method requires disclosing the available budget to invited sellers in the RFP and selecting the highest-
  • 527.
    ranking technical proposalwithin the budget. Because sellers are subject to a cost constraint, they will adapt the scope and quality of their offer to that budget. The buyer should therefore ensure that the budget is compatible with the SOW and that the seller will be able to perform the tasks within the budget. This method is appropriate only when the SOW is precisely defined, no changes are anticipated, and the budget is fixed and cannot be exceeded. 12.1.2.5 MEETINGS Research alone may not provide specific information to formulate a procurement strategy without additional information interchange meetings with potential bidders. By collaborating with potential bidders, the organization purchasing the material or service may benefit while the seller can influence a mutually beneficial approach or product. Meetings can be used to determine the strategy for managing and monitoring the procurement. 12.1.3 PLAN PROCUREMENT MANAGEMENT: OUTPUTS 12.1.3.1 PROCUREMENT MANAGEMENT PLAN The procurement management plan contains the activities to be undertaken during the procurement process. It should document whether international competitive bidding, national competitive bidding, local bidding, etc., should be done. If the project is financed externally, the sources and availability of funding should be aligned with the procurement management plan and the project schedule. The procurement management plan can include guidance for: How procurement will be coordinated with other project aspects, such as project schedule development and control processes; Timetable of key procurement activities; Procurement metrics to be used to manage contracts; Stakeholder roles and responsibilities related to procurement, including authority and constraints of the project team when the performing organization has a procurement department; Constraints and assumptions that could affect planned procurements;
  • 528.
    The legal jurisdictionand the currency in which payments will be made; Determination of whether independent estimates will be used and whether they are needed as evaluation criteria; Risk management issues including identifying requirements for performance bonds or insurance contracts to mitigate some forms of project risk; and Prequalified sellers, if any, to be used. A procurement management plan can be formal or informal, can be highly detailed or broadly framed, and is based upon the needs of each project. 12.1.3.2 PROCUREMENT STRATEGY Once the make-or-buy analysis is complete and the decision is made to acquire from outside the project, a procurement strategy should be identified. The objective of the procurement strategy is to determine the project delivery method, the type of legally binding agreement(s), and how the procurement will advance through the procurement phases. Delivery methods. Delivery methods are different for professional services versus construction projects. For professional services, delivery methods include: buyer/services provider with no subcontracting, buyer/services provider with subcontracting allowed, joint venture between buyer and services provider, and buyer/services provider acts as the representative. For industrial or commercial construction, project delivery methods include but are not limited to: turnkey, design build (DB), design bid build (DBB), design build operate (DBO), build own operate transfer (BOOT), and others. Contract payment types. Contract payment types are separate from the project delivery methods and are coordinated with the buying organization's internal financial systems. They include but are not limited to these contract types plus variations: lump sum, firm fixed price, cost plus award fees, cost plus incentive fees, time and materials, target cost, and others. Fixed-price contracts are suitable when the type of work is
  • 529.
    predictable and therequirements are well defined and not likely to change. Cost plus contracts are suitable when the work is evolving, likely to change, or not well defined. Incentives and awards may be used to align the objectives of buyer and seller. Procurement phases. The procurement strategy can also include information on procurement phases. Information may include: Sequencing or phasing of the procurement, a description of each phase and the specific objectives of each phase; Procurement performance indicators and milestones to be used in monitoring; Criteria for moving from phase to phase; Monitoring and evaluation plan for tracking progress; and Process for knowledge transfer for use in subsequent phases. 12.1.3.3 BID DOCUMENTS Bid documents are used to solicit proposals from prospective sellers. Terms such as bid, tender, or quotation are generally used when the seller selection decision is based on price (as when buying commercial or standard items), while a term such as proposal is generally used when other considerations such as technical capability or technical approach are the most important. Specific procurement terminology used may vary by industry and location of the procurement. Depending on the goods or services needed, the bidding documents can include a request for information, request for quotation, request for proposal, or other appropriate procurement documents. The conditions involving their use are presented below: Request for information (RFI). An RFI is used when more information on the goods and services to be acquired is needed from the sellers. It will typically be followed by an RFQ or RFP. Request for quotation (RFQ). An RFQ is commonly used when more information is needed on how vendors would satisfy the requirements and/or how much it will cost.
  • 530.
    Request for proposal(RFP). An RFP is used when there is a problem in the project and the solution is not easy to determine. This is the most formal of the “request for” documents and has strict procurement rules for content, timeline, and seller responses. The buyer structures procurement documents to facilitate an accurate and complete response from each prospective seller and to facilitate easy evaluation of the responses. These documents include a description of the desired form of the response, the relevant procurement SOW, and any required contractual provisions. The complexity and level of detail of the procurement documents should be consistent with the value of, and risks associated with, the planned procurement. Procurement documents are required to be sufficiently detailed to ensure consistent, appropriate responses, but flexible enough to allow consideration of any seller suggestions for better ways to satisfy the same requirements. 12.1.3.4 PROCUREMENT STATEMENT OF WORK The statement of work (SOW) for each procurement is developed from the project scope baseline and defines only that portion of the project scope that is to be included within the related contract. The SOW describes the procurement item in sufficient detail to allow prospective sellers to determine if they are capable of providing the products, services, or results. Sufficient detail can vary based on the nature of the item, the needs of the buyer, or the expected contract form. Information included in a SOW can include specifications, quantity desired, quality levels, performance data, period of performance, work location, and other requirements. The procurement SOW should be clear, complete, and concise. It includes a description of any collateral services required, such as performance reporting or post-project operational support for the procured item. The SOW can be revised as required as it moves through the procurement process until incorporated into a signed agreement. The phrase terms of reference (TOR) is sometimes used when contracting for services. Similar to the procurement SOW, a TOR typically includes these elements: Tasks the contractor is required to perform as well as specified coordination requirements; Standards the contractor will fulfill that are applicable to the project;
  • 531.
    Data that needsto be submitted for approval; Detailed list of all data and services that will be provided to the contractor by the buyer for use in performing the contract, if applicable; and Definition of the schedule for initial submission and the review/approval time required. 12.1.3.5 SOURCE SELECTION CRITERIA In choosing evaluation criteria, the buyer seeks to ensure that the proposal selected will offer the best quality for the services required. The source selection criteria may include but are not limited to: Capability and capacity; Product cost and life cycle cost; Delivery dates; Technical expertise and approach; Specific relevant experience; Adequacy of the proposed approach and work plan in responding to the SOW; Key staff's qualifications, availability, and competence; Financial stability of the firm; Management experience; and Suitability of the knowledge transfer program, including training. For international projects, evaluation criteria may include “local content” requirements, for example, participation by nationals among proposed key staff. The specific criteria may be a numerical score, color-code, or a written description of how well the seller satisfies the buying organization's needs. The criteria will be part of a weighting system that can be used to select a single seller that will be asked to sign a contract and establish a negotiating sequence by ranking all the proposals by the weighted evaluation scores assigned to each proposal. 12.1.3.6 MAKE-OR-BUY DECISIONS A make-or-buy analysis results in a decision as to whether particular work can
  • 532.
    best be accomplishedby the project team or needs to be purchased from outside sources. 12.1.3.7 INDEPENDENT COST ESTIMATES For large procurements, the procuring organization may elect to either prepare its own independent estimate or have a cost estimate prepared by an outside professional estimator to serve as a benchmark on proposed responses. Significant differences in cost estimates can be an indication that the procurement SOW was deficient or ambiguous, or that the prospective sellers either misunderstood or failed to respond fully to the procurement SOW. 12.1.3.8 CHANGE REQUESTS Described in Section 4.3.3.4. A decision that involves procuring goods, services, or resources may require a change request. Other decisions during procurement planning can also create the need for additional change requests. Changes to the project management plan, its subsidiary plans, and other components may result in change requests that impact procurement actions. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 12.1.3.9 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with any relevant lessons regarding regulations and compliance, data gathering, data analysis, and source selection analysis. Milestone list. Described in Section 6.2.3.3. This list of major milestones shows when the sellers are expected to deliver their results. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may include: Technical requirements that the seller is required to satisfy, and Requirements with contractual and legal implications that may include health, safety, security, performance, environmental, insurance, intellectual property rights, equal employment
  • 533.
    opportunity, licenses, permits,and other nontechnical requirements. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix links product requirements from their origin to the deliverables that satisfy them. Risk register. Described in Section 11.2.3.1. Each approved seller comes with its own unique set of risks, depending on the seller's organization, the duration of the contract, the external environment, the project delivery method, the type of contracting vehicle chosen, and the final agreed-upon price. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register is updated with any additional information on stakeholders, particularly regulatory agencies, contracting personnel, and legal personnel. 12.1.3.10 ORGANIZATIONAL PROCESS ASSETS UPDATES Organizational process assets that are updated as a result of the Plan Procurement Management process include but are not limited to information on qualified sellers. For projects with few procurements and relatively simple procurements, some of these outputs may be combined. However, for projects with large, complex procurements and where much of the work is done by contractors, there are several different types of documentation. Table 12-1 is a representative list of common types of documents used in procurements and some of their contents. Given the legal nature of procurements, this list should not be considered prescriptive, but rather it should be used as a general outline of types of documents and contents needed to conduct procurement. The organization, environment, and legal constraints dictate the required procurement documents and information needed for the project.
  • 534.
    12.2 CONDUCT PROCUREMENTS ConductProcurements is the process of obtaining seller responses, selecting a seller, and awarding a contract. The key benefit of this process is that it selects a qualified seller and implements the legal agreement for delivery. The end results of the process are the established agreements including formal contracts. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of the Conduct Procurements process are depicted in Figure 12-4. Figure 12-5 depicts the data flow diagram for the process.
  • 536.
    12.2.1 CONDUCT PROCUREMENTS:INPUTS 12.2.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Scope management plan. Described in Section 5.1.3.1. The scope management plan describes how the overall scope of work will be managed, including the scope performed by sellers. Requirements management plan. Described in Section 5.1.3.2. The
  • 537.
    requirements management plandescribes how requirements will be analyzed, documented, and managed. The requirements management plan may include how sellers will manage the requirements they are under agreement to satisfy. Communications management plan. Described in Section 10.1.3.1. The communications management plan describes how communications between buyers and sellers will be conducted. Risk management plan. Described in Section 11.1.3.1. The risk management plan is a component of the project management plan and describes how risk management activities will be structured and performed for the project. Procurement management plan. Described in Section 12.1.3.1. The procurement management plan contains the activities to be undertaken during the Conduct Procurements process. Configuration management plan. Described in Section 5.6.1.1. The configuration management plan defines those items that are configurable, those items that require formal change control, and the process for controlling changes to such items. It includes formats and processes for how sellers will provide configuration management in a way that is consistent with the buyer's approach. Cost baseline. Described in Section 7.3.3.1. The cost baseline includes the budget for the procurement as well as costs associated with managing the procurement process and sellers. 12.2.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs for this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to conducting procurements can be applied to later phases in the project to improve the efficiency of this process. Project schedule. Described in Section 6.5.3.2. The project schedule identifies the start and end dates of project activities, including procurement activities. It also defines when contractor deliverables are due.
  • 538.
    Requirements documentation. Describedin Section 5.2.3.1. Requirements documentation may include: Technical requirements the seller is required to satisfy, and Requirements with contractual and legal implications that may include health, safety, security, performance, environmental, insurance, intellectual property rights, equal employment opportunity, licenses, permits, and other nontechnical requirements. Risk register. Described in Section 11.2.3.1. Each approved seller comes with its own unique set of risks, depending on the seller's organization, the duration of the contract, the external environment, the project delivery method, the type of contracting vehicle chosen, and the final agreed-upon price. Stakeholder register. Described in Section 13.1.3.1. This document contains all of the details about the identified stakeholders. 12.2.1.3 PROCUREMENT DOCUMENTATION Procurement documentation provides a written record used in reaching the legal agreement, and may include older documents predating the current project. Procurement documentation can include: Bid documents. Described in Section 12.1.3.3. Procurement documents include the RFI, RFP, RFQ, or other documents sent to sellers so they can develop a bid response. Procurement statement of work. Described in Section 12.1.3.4. The procurement statement of work (SOW) provides sellers with a clearly stated set of goals, requirements, and outcomes from which they can provide a quantifiable response. Independent cost estimates. Described in Section 12.1.3.7. Independent cost estimates are developed either internally or by using external resources and provide a reasonableness check against the proposals submitted by bidders. Source selection criteria. Described in Section 12.1.3.5. These criteria describe how bidder proposals will be evaluated, including evaluation criteria and weights. For risk mitigation, the buyer may decide to sign agreements with more than one seller to mitigate damage caused by a
  • 539.
    single seller havingproblems that impact the overall project. 12.2.1.4 SELLER PROPOSALS Seller proposals, prepared in response to a procurement document package, form the basic information that will be used by an evaluation body to select one or more successful bidders (sellers). If the seller is going to submit a price proposal, good practice is to require that it be separate from the technical proposal. The evaluation body reviews each submitted proposal according to the source selection criteria and selects the seller that can best satisfy the buying organization's requirements. 12.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Conduct Procurements Process include: Local laws and regulations regarding procurements; Local laws and regulations ensuring that the major procurements involve local sellers; External economic environment constraining procurement processes; Marketplace conditions; Information on relevant past experience with sellers, both good and bad; Prior agreements already in place; and Contract management systems. 12.2.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Conduct Procurements process include but are not limited to: List of preferred sellers that have been prequalified, Organizational policies that influence the selection of a seller, Specific organizational templates or guidelines that will determine the way agreements are drafted and built, and Financial policies and procedures regarding invoicing and payment processes.
  • 540.
    12.2.2 CONDUCT PROCUREMENTS:TOOLS AND TECHNIQUES 12.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Proposal evaluation; Technical or subject matter; Relevant functional areas such as finance, engineering, design, development, supply chain management, etc.; Industry regulatory environment; Laws, regulations, and compliance requirements; and Negotiation. 12.2.2.2 ADVERTISING Advertising is communicating with users or potential users of a product, service, or result. Existing lists of potential sellers often can be expanded by placing advertisements in general circulation publications such as selected newspapers or in specialty trade publications. Most government jurisdictions require public advertising or online posting of pending government contracts. 12.2.2.3 BIDDER CONFERENCES Bidder conferences (also called contractor conferences, vendor conferences, and pre-bid conferences) are meetings between the buyer and prospective sellers prior to proposal submittal. They are used to ensure that all prospective bidders have a clear and common understanding of the procurement and no bidders receive preferential treatment. 12.2.2.4 DATA ANALYSIS A data analysis technique that can be used for this process includes but is not limited to proposal evaluation. Proposals are evaluated to ensure they are complete and respond in full to the bid documents, procurement statement of work, source selection criteria, and any other documents that went out in the bid package.
  • 541.
    12.2.2.5 INTERPERSONAL ANDTEAM SKILLS Interpersonal and team skills that can be used for this process include negotiation. Negotiation is a discussion aimed at reaching an agreement. Procurement negotiation clarifies the structure, rights, and obligations of the parties and other terms of the purchases so that mutual agreement can be reached prior to signing the contract. Final document language reflects all agreements reached. Negotiation concludes with a signed contract document or other formal agreement that can be executed by both buyer and seller. The negotiation should be led by a member of the procurement team that has the authority to sign contracts. The project manager and other members of the project management team may be present during negotiation to provide assistance as needed. 12.2.3 CONDUCT PROCUREMENTS: OUTPUTS 12.2.3.1 SELECTED SELLERS The selected sellers are those who have been judged to be in a competitive range based on the outcome of the proposal or bid evaluation. Final approval of complex, high-value, high-risk procurements will generally require organizational senior management approval prior to award. 12.2.3.2 AGREEMENTS A contract is a mutually binding agreement that obligates the seller to provide the specified products, services, or results; obligates the buyer to compensate the seller; and represents a legal relationship that is subject to remedy in the courts. The major components in an agreement document will vary, and may include but are not limited to: Procurement statement of work or major deliverables; Schedule, milestones, or date by which a schedule is required; Performance reporting; Pricing and payment terms; Inspection, quality, and acceptance criteria; Warranty and future product support; Incentives and penalties;
  • 542.
    Insurance and performancebonds; Subordinate subcontractor approvals; General terms and conditions; Change request handling; and Termination clause and alternative dispute resolution mechanisms. 12.2.3.3 CHANGE REQUESTS Described in Section 4.3.3.4. Change requests to the project management plan, its subsidiary plans, and other components are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 12.2.3.4 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components of the project management plan that may require a change request for the project management plan include but are not limited to: Requirements management plan. Described in Section 5.1.3.2. There may be changes to project requirements due to changes identified by sellers. Quality management plan. Described in Section 8.1.3.1. Sellers may offer alternative quality standards or alternative solutions that impact the quality approaches defined in the quality management plan. Communications management plan. Described in Section 10.1.3.1. As sellers are hired, the communications management plan is updated to incorporate their communications needs and approaches. Risk management plan. Described in Section 11.1.3.1. Each agreement and seller has its own set of risks that may require updates to the risk management plan. Specific risks are incorporated into the risk register. Procurement management plan. Described in Section 12.1.3.1. Updates may be required depending on the results of the contracting and negotiations processes. Scope baseline. Described in Section 5.4.3.1. The project WBS and deliverables documented in the scope baseline are considered when
  • 543.
    performing procurement activities.Any one or all of these may change during the procurement process. Schedule baseline. Described in Section 6.5.3.1. If there are delivery changes created by sellers that impact overall project schedule performance, the baseline schedule may need to be updated and approved to reflect the current expectations. Cost baseline. Described in Section 7.3.3.1. Contractor and materials prices can change frequently during the delivery of a project. These changes can occur because of fluctuating materials and labor prices created by the external economic environment and need to be incorporated into the cost baseline. 12.2.3.5 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with information on challenges encountered while conducting procurements and how they could have been avoided as well as approaches that worked well. Requirements documentation. Described in Section 5.2.3.1. Requirements documentation may include: Technical requirements that the seller is required to satisfy, and Requirements with contractual and legal implications that may include health, safety, security, performance, environmental, insurance, intellectual property rights, equal employment opportunity, licenses, permits, and other nontechnical requirements. Requirements traceability matrix. Described in Section 5.2.3.2. As sellers are incorporated into the project's plan, the requirements register and the traceability matrix may change depending on the capabilities of the specific seller. Resource calendars. Described in Section 9.2.1.2. Schedule resource calendars may need to be updated depending on the availabilities of the sellers. Risk register. Described in Section 11.2.3.1. Each approved seller
  • 544.
    comes with itsown unique set of risks, depending on the seller's organization, the duration of the contract, the external environment, the project delivery method, the type of contracting vehicle chosen, and the final agreed-upon price. Changes are made to the risk register during the contracting process, which reflect the specific risks of each seller. Stakeholder register. Described in Section 13.1.3.1. This document contains all the details about the identified stakeholders. The stakeholder register is updated as agreements are made with specific sellers. 12.2.3.6 ORGANIZATIONAL PROCESS ASSETS UPDATES Elements of the organizational process assets that can be updated as a result of the Conduct Procurements process can include: Listings of prospective and prequalified sellers; and Information on relevant experience with sellers, both good and bad. 12.3 CONTROL PROCUREMENTS Control Procurements is the process of managing procurement relationships; monitoring contract performance, and making changes and corrections as appropriate; and closing out contracts. The key benefit of this process is that it ensures that both the seller's and buyer's performance meet the project's requirements according to the terms of the legal agreement. This process is performed throughout the project as needed. The inputs, tools and techniques, and outputs of this process are depicted in Figure 12-6. Figure 12-7 depicts the data flow diagram of the process.
  • 546.
    Both the buyerand the seller administer the procurement contract for similar purposes. Each is required to ensure that both parties meet their contractual obligations and that their own legal rights are protected. The legal nature of the relationship makes it imperative that the project management team is aware of the implications of actions taken when controlling any procurement. On larger projects with multiple providers, a key aspect of contract administration is managing communication among the various providers. Because of the legal aspect, many organizations treat contract administration as an organizational function that is separate from the project. While a procurement administrator may be on the project team, this individual typically reports to a supervisor from a different department.
  • 547.
    Control Procurements includesapplication of the appropriate project management processes to the contractual relationship(s) and integration of the outputs from these processes into the overall management of the project. This integration often occurs at multiple levels when there are multiple sellers and multiple products, services, or results involved. Administrative activities may include: Collection of data and managing project records, including maintenance of detailed records of physical and financial performance and establishment of measurable procurement performance indicators; Refinement of procurement plans and schedules; Set up for gathering, analyzing, and reporting procurement-related project data and preparation of periodic reports to the organization; Monitoring the procurement environment so that implementation can be facilitated or adjustments made; and Payment of invoices. The quality of the controls, including the independence and credibility of procurement audits, is critical to the reliability of the procurement system. The organization's code of ethics, its legal counsel, and external legal advisory arrangements including any ongoing anti-corruption initiatives can contribute to proper procurement controls. Control Procurements has a financial management component that involves monitoring payments to the seller. This ensures that payment terms defined within the contract are met and that compensation is linked to the seller's progress as defined in the contract. A principal concern when making payments is to ensure there is a close relationship of payments made to the work accomplished. A contract that requires payments linked to project output and deliverables rather than inputs such as labor hours has better controls. Agreements can be amended at any time prior to contract closure by mutual consent, in accordance with the change control terms of the agreement. Such amendments are typically captured in writing. 12.3.1 CONTROL PROCUREMENTS: INPUTS 12.3.1.1 PROJECT MANAGEMENT PLAN
  • 548.
    Described in Section4.2.3.1. Project management plan components include but are not limited to: Requirements management plan. Described in Section 5.1.3.2. The requirements management plan describes how contractor requirements will be analyzed, documented, and managed. Risk management plan. Described in Section 11.1.3.1. The risk management plan describes how risk activities created by sellers will be structured and performed for the project. Procurement management plan. Described in Section 12.1.3.2. The procurement management plan contains the activities to be performed during the Control Procurement process. Change management plan. Described in Section 4.2.3.1. The change management plan contains information about how seller-created changes will be processed. Schedule baseline. Described in Section 6.5.3.1. If there are slippages created by sellers that impact overall project performance, the schedule may need to be updated and approved to reflect the current expectations. 12.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs to this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log documents the assumptions that have been made during the procurement process. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied further along in the project to improve contractor performance and the procurement process. Milestone list. Described in Section 6.2.3.3. This list of major milestones shows when the sellers are expected to deliver their results. Quality reports. Described in Section 8.2.3.1. The quality reports can identify seller processes, procedures, or products that are out of compliance. Requirements documentation. Described in Section 5.2.3.1.
  • 549.
    Requirements documentation mayinclude: Technical requirements the seller is required to satisfy, and Requirements with contractual and legal implications that may include health, safety, security, performance, environmental, insurance, intellectual property rights, equal employment opportunity, licenses, permits, and other nontechnical requirements. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix links product requirements from their origin to the deliverables that satisfy them. Risk register. Described in Section 11.2.3.1. Each approved seller comes with its own unique set of risks, depending on the seller's organization, the duration of the contract, the external environment, the project delivery method, the type of contracting vehicle chosen, and the final agreed-upon price. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register includes information about identified stakeholders, including contracted team members, selected sellers, contracting officers, and other stakeholders who are involved in procurements. 12.3.1.3 AGREEMENTS Described in Section 12.2.3.2. Agreements are understandings between parties, including understanding of the duties of each party. The relevant agreements are reviewed to verify terms and conditions are met. 12.3.1.4 PROCUREMENT DOCUMENTATION Procurement documentation contains complete supporting records for administration of the procurement processes. Procurement documentation includes the statement of work, payment information, contractor work performance information, plans, drawings, and other correspondence. 12.3.1.5 APPROVED CHANGE REQUESTS Described in Section 4.6.3.1. Approved change requests can include modifications to the terms and conditions of the contract, including the procurement statement of work (SOW), pricing, and descriptions of the products, services, or results to be provided. All procurement-related changes are
  • 550.
    formally documented inwriting and approved before being implemented through the Control Procurements process. In complex projects and programs, change requests may come from sellers involved with the project that can influence other involved sellers. The project should have the capability of identifying, communicating, and resolving changes that impact the work of multiple sellers. 12.3.1.6 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains seller data on project status such as technical performance; activities that have started, are in progress, or have completed; and costs that have been incurred or committed. Work performance data can also include information on the seller invoices that have been paid. 12.3.1.7 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Control Procurements process include but are not limited to: Contract change control system, Marketplace conditions, Financial management and accounts payable system, and Buying organization's code of ethics. 12.3.1.8 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Control Procurements process include but are not limited to, procurement policies. 12.3.2 CONTROL PROCUREMENTS: TOOLS AND TECHNIQUES 12.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1 Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Relevant functional areas such as finance, engineering, design,
  • 551.
    development, supply chainmanagement, etc.; Laws, regulations, and compliance requirements; and Claims administration. 12.3.2.2 CLAIMS ADMINISTRATION Contested changes and potential constructive changes are those requested changes where the buyer and seller cannot reach an agreement on compensation for the change or cannot agree that a change has occurred. These contested changes are called claims. When they cannot be resolved, they become disputes and finally appeals. Claims are documented, processed, monitored, and managed throughout the contract life cycle, usually in accordance with the terms of the contract. If the parties themselves do not resolve a claim, it may have to be handled in accordance with alternative dispute resolution (ADR) typically following procedures established in the contract. Settlement of all claims and disputes through negotiation is the preferred method. 12.3.2.3 DATA ANALYSIS Data analysis techniques that can be used to monitor and control procurements include but are not limited to: Performance Reviews. Performance reviews for contracts measure, compare, and analyze quality, resource, schedule, and cost performance against the agreement. This includes identifying work packages that are ahead or behind schedule, over or under budget, or have resource or quality issues. Earned Value Analysis (EVA). Described in Section 7.4.2.2. Schedule and cost variances along with schedule and cost performance indexes are calculated to determine the degree of variance from target. Trend Analysis. Described in Section 4.5.2.2. Trend analysis can develop a forecast estimate at completion (EAC) for cost performance to see if performance is improving or deteriorating. See 7.4.2.2 for more detail on EAC methods. 12.3.2.4 INSPECTION An inspection is a structured review of the work being performed by the contractor. This may involve a simple review of the deliverables or an actual
  • 552.
    physical review ofthe work itself. On a construction/engineering/infrastructure project, inspections involve walkthroughs of the site by both the buyer and the contractor to ensure a mutual understanding of the work in progress. 12.3.2.5 AUDITS Audits are described in Section 8.2.2.5. Audits are a structured review of the procurement process. Rights and obligations related to audits should be described in the procurement contract. Resulting audit observations should be brought to the attention of the buyer's project manager and the seller's project manager for adjustments to the project, when necessary. 12.3.3 CONTROL PROCUREMENTS: OUTPUTS 12.3.3.1 CLOSED PROCUREMENTS The buyer, usually through its authorized procurement administrator, provides the seller with formal written notice that the contract has been completed. Requirements for formal procurement closure are usually defined in the terms and conditions of the contract and are included in the procurement management plan. Typically, all deliverables should have been provided on time and meet technical and quality requirements, there should be no outstanding claims or invoices, and all final payments should have been made. The project management team should have approved all deliverables prior to closure. 12.3.3.2 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information on how a seller is performing by comparing the deliverables received, the technical performance achieved, and the costs incurred and accepted against the SOW budget for the work performed. 12.3.3.3 PROCUREMENT DOCUMENTATION UPDATES Procurement documentation that may be updated includes the contract with all supporting schedules, requested unapproved contract changes, and approved change requests. Procurement documentation also includes any seller-developed technical documentation and other work performance information such as deliverables, seller performance reports and warranties, financial documents including invoices and payment records, and the results of contract-related
  • 553.
    inspections. 12.3.3.4 CHANGE REQUESTS Describedin Section 4.3.3.4. Change requests to the project management plan, its subsidiary plans, and other components such as the cost baseline, schedule baseline, and procurement management plan, may result from the Control Procurements process. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). Requested but unresolved changes can include direction provided by the buyer or actions taken by the seller, which the other party considers a constructive change to the contract. Since any of these constructive changes may be disputed by one party and can lead to a claim against the other party, such changes are uniquely identified and documented by project correspondence. 12.3.3.5 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Risk management plan. Described in Section 11.1.3.1. Each agreement and seller has its own set of risks that may require updates to the risk management plan. If significant unexpected risks occur during the execution of the contract, the risk management plan may require updating. Specific risks are incorporated into the risk register. Procurement management plan. Described in Section 12.1.3.1. The procurement management plan contains the activities to be undertaken during the procurement process. Updates may be required depending on the results of the performance of the sellers during execution of the work. Schedule baseline. Described in Section 6.5.3.1. If there are significant schedule changes created by sellers that impact overall project schedule performance, the baseline schedule may need to be updated and approved to reflect the current expectations. The buyer should be aware of any cascading impacts of schedule delays created by a seller that impact other sellers. Cost baseline. Described in Section 7.3.3.1. Contractor and material
  • 554.
    costs can changefrequently during the delivery of a project. These changes can occur because of fluctuating materials and labor prices created by the external economic environment and need to be incorporated into the cost baseline. 12.3.3.6 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Lessons learned register. Described in Section 4.4.3.1. The lessons learned register can be updated with techniques that were effective in maintaining the scope, schedule, and cost of the procured items. Where variances occurred, the register should show the corrective actions that were used to respond to variances and how effective those actions were. If there are any claims, information should be documented to avoid recurrences. Additional information on how to improve the procurement process can also be recorded. Resource requirements. Described in Section 9.2.3.1. As the work progresses by the contractors, there may be changes to the resource requirements resulting from work being done that is not in accordance with the planned work schedule. Requirements traceability matrix. Described in Section 5.2.3.2. The requirements traceability matrix is updated with information on requirements that have been satisfied. Risk register. Described in Section 11.2.3.1. Each approved seller comes with its own unique set of risks, depending on the seller's organization, the duration of the contract, the external environment, the project delivery method, the type of contracting vehicle chosen, and the final agreed-upon price. Changes are made to the risk register during the execution of the project, as early risks may no longer be applicable and new risks occur. Stakeholder register. Described in Section 13.1.3.1. As the work progresses through the execution phase, the contractors and suppliers may change. These changes should be reflected in the stakeholder register. 12.3.3.7 ORGANIZATIONAL PROCESS ASSETS UPDATES
  • 555.
    Organizational process assetsthat can be updated as a result of the Control Procurements process include but are not limited to: Payment schedules and requests. All payments should be made in accordance with the procurement contract terms and conditions. Seller performance evaluation documentation. Seller performance evaluation documentation is prepared by the buyer and documents the seller's ability to continue to perform work on the current contract, indicates whether the seller can be allowed to perform work on future projects, or rates how well the seller is performing the project work or has performed in the past. Prequalified seller lists updates. Prequalified seller lists are lists of potential sellers who are previously qualified (approved). These lists will be updated according to the Procurement Control process outcomes because sellers could be disqualified and removed from the lists based on poor performance. Lessons learned repository. Lessons learned should be archived in the lessons learned repository to improve procurements on future projects. At the end of a contract, the actual results of the procurement are compared with the projected results in the original procurement management plan. These lessons learned state whether the project objectives were achieved and, if not, provides the reasons they were not. Procurement file. A complete set of indexed contract documentation, including the closed contract, is prepared for inclusion with the final project files.
  • 556.
    13 PROJECT STAKEHOLDER MANAGEMENT ProjectStakeholder Management includes the processes required to identify the people, groups, or organizations that could impact or be impacted by the project, to analyze stakeholder expectations and their impact on the project, and to develop appropriate management strategies for effectively engaging stakeholders in project decisions and execution. The processes support the work of the project team to analyze stakeholder expectations, assess the degree to which they impact or are impacted by the project, and develop strategies to effectively engage stakeholders in support of project decisions and the planning and execution of the work of the project. The Project Stakeholder Management processes are: 13.1 Identify Stakeholders—The process of identifying project stakeholders regularly and analyzing and documenting relevant information regarding their interests, involvement, interdependencies, influence, and potential impact on project success. 13.2 Plan Stakeholder Engagement—The process of developing approaches to involve project stakeholders based on their needs, expectation, interests, and potential impact on the project. 13.3 Manage Stakeholder Engagement—The process of communicating and working with stakeholders to meet their needs and expectations, address issues, and foster appropriate stakeholder engagement involvement. 13.4 Monitor Stakeholder Engagement—The process of monitoring project stakeholder relationships and tailoring strategies for engaging stakeholders through the modification of engagement strategies and plans. Figure 13-1 provides an overview of the Project Stakeholder Management processes. The Project Stakeholder Management processes are presented as discrete processes with defined interfaces while, in practice, they overlap and interact in ways that cannot be completely detailed in the PMBOK® Guide.
  • 557.
    KEY CONCEPTS FORPROJECT STAKEHOLDER MANAGEMENT Every project has stakeholders who are impacted by or can impact the project in a positive or negative way. Some stakeholders may have a limited ability to influence the project's work or outcomes; others may have significant influence on the project and its expected outcomes. Academic research and analyses of high-profile project disasters highlight the importance of a structured approach to the identification, prioritization, and engagement of all stakeholders. The ability of the project manager and team to correctly identify and engage all stakeholders in an appropriate way can mean the difference between project success and failure. To increase the chances of success, the process of stakeholder identification and engagement should commence as soon as possible after the project charter has been approved, the project manager has been assigned and the team begins to form. Stakeholder satisfaction should be identified and managed as a project objective. The key to effective stakeholder engagement is a focus on continuous communication with all stakeholders, including team members, to understand their needs and expectations, address issues as they occur, manage conflicting interests, and foster appropriate stakeholder engagement in project decisions and activities.
  • 558.
    The process ofidentifying and engaging stakeholders for the benefit of the project is iterative. Although the processes in Project Stakeholder Management are described only once, the activities of identification, prioritization, and engagement should be reviewed and updated routinely, and at least at the following times when: The project moves through different phases in its life cycle, Current stakeholders are no longer involved in the work of the project or new stakeholders become members of the project's stakeholder community, or There are significant changes in the organization or the wider stakeholder community. TRENDS AND EMERGING PRACTICES IN PROJECT STAKEHOLDER ENGAGEMENT Broader definitions of stakeholders are being developed that expand the traditional categories of employees, suppliers, and shareholders to include groups such as regulators, lobby groups, environmentalists, financial organizations, the media, and those who simply believe they are stakeholders— they perceive that they will be affected by the work or outcomes of the project. Trends and emerging practices for Project Stakeholder Management include but are not limited to: Identifying all stakeholders, not just a limited set; Ensuring that all team members are involved in stakeholder engagement activities; Reviewing the stakeholder community regularly, often in parallel with reviews of individual project risks; Consulting with stakeholders who are most affected by the work or outcomes of the project through the concept of co-creation. Co- creation places greater emphasis on including affected stakeholders in the team as partners; and Capturing the value of effective stakeholder engagement, both positive and negative. Positive value can be based on the consideration of benefits derived from higher levels of active support from stakeholders, particularly powerful stakeholders. Negative value can
  • 559.
    be derived bymeasuring the true costs of not engaging stakeholders effectively, leading to product recalls or loss of organizational or project reputation. TAILORING CONSIDERATIONS Because each project is unique, the project manager may need to tailor the way Project Stakeholder Management processes are applied. Considerations for tailoring include but are not limited to: Stakeholder diversity. How many stakeholders are there? How diverse is the culture within the stakeholder community? Complexity of stakeholder relationships. How complex are the relationships within the stakeholder community? The more networks a stakeholder or stakeholder group participates in, the more complex the networks of information and misinformation the stakeholder may receive. Communication technology. What communication technology is available? What support mechanisms are in place to ensure that best value is achieved from the technology? CONSIDERATIONS FOR AGILE/ADAPTIVE ENVIRONMENTS Projects experiencing a high degree of change require active engagement and participation with project stakeholders. To facilitate timely, productive discussion and decision making, adaptive teams engage with stakeholders directly rather than going through layers of management. Often the client, user, and developer exchange information in a dynamic co-creative process that leads to more stakeholder involvement and higher satisfaction. Regular interactions with the stakeholder community throughout the project mitigate risk, build trust, and support adjustments earlier in the project cycle, thus reducing costs and increasing the likelihood of success for the project. In order to accelerate the sharing of information within and across the organization, agile methods promote aggressive transparency. The intent of inviting any stakeholders to project meetings and reviews or posting project artifacts in public spaces is to surface as quickly as possible any misalignment, dependency, or other issue related to the changing project.
  • 560.
    13.1 IDENTIFY STAKEHOLDERS IdentifyStakeholders is the process of identifying project stakeholders regularly and analyzing and documenting relevant information regarding their interests, involvement, interdependencies, influence, and potential impact on project success. The key benefit of this process is that it enables the project team to identify the appropriate focus for engagement of each stakeholder or group of stakeholders. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of the process are depicted in Figure 13-2. Figure 13-3 depicts the data flow diagram for the process.
  • 561.
    This process frequentlyoccurs for the first time in a project either prior to or at the same time the project charter is developed and approved. It is repeated as necessary, but should be performed at the start of each phase and when a significant change in the project or the organization occurs. Each time the identification process is repeated, the project management plan components and project documents should be consulted to identify relevant project stakeholders. 13.1.1 IDENTIFY STAKEHOLDERS: INPUTS 13.1.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter identifies the key stakeholder list. It may also contain information about the responsibilities of the
  • 562.
    stakeholders. 13.1.1.2 BUSINESS DOCUMENTS Inthe first iteration of the Identify Stakeholders process, the business case and the benefits management plan are sources of information about the project's stakeholders. Business case. Described in Section 1.2.6.1. The business case identifies the project objectives and identifies an initial list of stakeholders affected by the project. Benefits management plan. Described in Section 1.2.6.2. The benefits management plan describes the expected plan for realizing the benefits claimed in the business case. It may identify the individuals and groups that will benefit from the delivery of the outcomes of the project and are thus considered as stakeholders. 13.1.1.3 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. The project management plan is not available when initially identifying stakeholders; however, once it has been developed, project management plan components include but are not limited to: Communications management plan. Described in Section 10.1.3.1. Communications and stakeholder engagement are strongly linked. Information included in the communications management plan is a source of knowledge about the project's stakeholders. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan identifies the management strategies and actions required to effectively engage stakeholders. 13.1.1.4 PROJECT DOCUMENTS It is unlikely that any project documents will be an input for the initial stakeholder identification. However, stakeholder identification occurs throughout the project. Once the project is past the startup phase, more documents become available and are used throughout the project. Project documents that can be considered as inputs for this process include but are not limited to: Change log. Described in Section 4.6.3.3. The change log may
  • 563.
    introduce a newstakeholder or change the nature of an existing stakeholder's relationship to the project. Issue log. Described in Section 4.3.3.3. The issue log records issues that may introduce new stakeholders to the project or change the type of participation of existing stakeholders. Requirements documentation. Described in Section 5.2.3.1. Requirements can provide information on potential stakeholders. 13.1.1.5 AGREEMENTS Described in Section 12.2.3.2. The parties of an agreement are project stakeholders. The agreement can contain references to additional stakeholders. 13.1.1.6 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Identify Stakeholders process include but are not limited to: Organizational culture, political climate, and governance framework; Government or industry standards (regulations, product standards, and codes of conduct); Global, regional, or local trends and practices or habits; and Geographic distribution of facilities and resources. 13.1.1.7 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Identify Stakeholders process include but are not limited to: Stakeholder register templates and instructions, Stakeholder registers from previous projects, and Lessons learned repository with information about the preferences, actions, and involvement of stakeholders. 13.1.2 IDENTIFY STAKEHOLDERS: TOOLS AND TECHNIQUES 13.1.2.1 EXPERT JUDGMENT
  • 564.
    Described in Section4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Understanding the politics and power structures in the organization, Knowledge of the environment and culture of the organization and other affected organizations including customers and the wider environment, Knowledge of the industry or type of project deliverable, and Knowledge of individual team member contributions and expertise. 13.1.2.2 DATA GATHERING Data-gathering techniques that can be used for this process include but are not limited to: Questionnaires and surveys. Described in Section 5.2.2.2. Questionnaires and surveys can include one-on-one reviews, focus group sessions, or other mass information collection techniques. Brainstorming. Described in Section 4.1.2.2. Brainstorming as used to identify stakeholders can include both brainstorming and brain writing. Brainstorming. A general data-gathering and creativity technique that elicits input from groups such as team members or subject matter experts. Brain writing. A refinement of brainstorming that allows individual participants time to consider the question(s) individually before the group creativity session is held. The information can be gathered in face-to-face groups or using virtual environments supported by technology. 13.1.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Stakeholder analysis. Stakeholder analysis results in a list of stakeholders and relevant information such as their positions in the organization, roles on the project, “stakes,” expectations, attitudes (their levels of support for the project), and their interest in information about the project. Stakeholders’ stakes can include but are
  • 565.
    not limited toa combination of: Interest. A person or group can be affected by a decision related to the project or its outcomes. Rights (legal or moral rights). Legal rights, such as occupational health and safety, may be defined in the legislation framework of a country. Moral rights may involve concepts of protection of historical sites or environmental sustainability. Ownership. A person or group has a legal title to an asset or a property. Knowledge. Specialist knowledge, which can benefit the project through more effective delivery of project objectives, organizational outcomes, or knowledge of the power structures of the organization. Contribution. Provision of funds or other resources, including human resources, or providing support for the project in more intangible ways, such as advocacy in the form of promoting the objectives of the project or acting as a buffer between the project and the power structures of the organization and its politics. Document analysis. Described in Section 5.2.2.3. Assessing the available project documentation and lessons learned from previous projects to identify stakeholders and other supporting information. 13.1.2.4 DATA REPRESENTATION A data representation technique that may be used in this process includes but is not limited to stakeholder mapping/representation. Stakeholder mapping and representation is a method of categorizing stakeholders using various methods. Categorizing stakeholders assists the team in building relationships with the identified project stakeholders. Common methods include: Power/interest grid, power/influence grid, or impact/influence grid. Each of these techniques supports a grouping of stakeholders according to their level of authority (power), level of concern about the project's outcomes (interest), ability to influence the outcomes of the project (influence), or ability to cause changes to the project's planning or execution. These classification models are useful for small projects or for projects with simple relationships between stakeholders and the project, or within the stakeholder community itself.
  • 566.
    Stakeholder cube. Thisis a refinement of the grid models previously mentioned. This model combines the grid elements into a three- dimensional model that can be useful to project managers and teams in identifying and engaging their stakeholder community. It provides a model with multiple dimensions that improves the depiction of the stakeholder community as a multidimensional entity and assists with the development of communication strategies. Salience model. Describes classes of stakeholders based on assessments of their power (level of authority or ability to influence the outcomes of the project), urgency (need for immediate attention, either time-constrained or relating to the stakeholders’ high stake in the outcome), and legitimacy (their involvement is appropriate). There is an adaptation of the salience model that substitutes proximity for legitimacy (applying to the team and measuring their level of involvement with the work of the project). The salience model is useful for large complex communities of stakeholders or where there are complex networks of relationships within the community. It is also useful in determining the relative importance of the identified stakeholders. Directions of influence. Classifies stakeholders according to their influence on the work of the project or the project team itself. Stakeholders can be classified in the following ways: Upward (senior management of the performing organization or customer organization, sponsor, and steering committee), Downward (the team or specialists contributing knowledge or skills in a temporary capacity), Outward (stakeholder groups and their representatives outside the project team, such as suppliers, government departments, the public, end-users, and regulators), or Sideward (the peers of the project manager, such as other project managers or middle managers who are in competition for scarce project resources or who collaborate with the project manager in sharing resources or information). Prioritization. Prioritizing stakeholders may be necessary for projects with a large number of stakeholders, where the membership of the stakeholder community is changing frequently, or when the
  • 567.
    relationships between stakeholdersand the project team or within the stakeholder community are complex. 13.1.2.5 MEETINGS Meetings are used to develop an understanding of significant project stakeholders. They can take the form of facilitation workshops, small group guided discussions, and virtual groups using electronics or social media technologies to share ideas and analyze data. 13.1.3 IDENTIFY STAKEHOLDERS: OUTPUTS 13.1.3.1 STAKEHOLDER REGISTER The main output of the Identify Stakeholders process is the stakeholder register. This document contains information about identified stakeholders that includes but is not limited to: Identification information. Name, organizational position, location and contact details, and role on the project. Assessment information. Major requirements, expectations, potential for influencing project outcomes, and the phase of the project life cycle where the stakeholder has the most influence or impact. Stakeholder classification. Internal/external, impact/influence/power/interest, upward/downward/outward/sideward, or any other classification model chosen by the project manager. 13.1.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. During the first iteration of identifying stakeholders, there will not be any change requests. As stakeholder identification continues throughout the project, new stakeholders, or new information about stakeholders, may result in a change request to the product, project management plan, or project documents. Change requests are processed for review and disposition through the Perform Integrated Change Control (Section 4.6) process. 13.1.3.3 PROJECT MANAGEMENT PLAN UPDATES
  • 568.
    When stakeholders areidentified at the very beginning of a project, there will not be updates to the project management plan. As the project progresses, any change to the project management plan goes through the organization's change control process via a change request. Components that may require a change request for the project management plan include but are not limited to: Requirements management plan. Described in Section 5.1.1.2. Newly identified stakeholders can impact how requirements activities will be planned, tracked, and reported. Communications management plan. Described in Section 10.1.3.1. Stakeholder communication requirements and agreed-upon communications strategies are recorded in the communications management plan. Risk management plan. Described in Section 11.1.3.1. Where stakeholder communication requirements and agreed-upon communications strategies affect the approach to managing risk on the project, this is reflected in the risk management plan. Stakeholder engagement plan. Described in Section 13.2.3.1. Agreed- upon communications strategies for identified stakeholders are recorded in the stakeholder engagement plan. 13.1.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Assumption log. Described in Section 4.1.3.2. Much of the information about the relative power, interest, and engagement of stakeholders is based on assumptions. This information is entered into the assumption log. Additionally, any constraints associated with interacting with specific stakeholders are entered as well. Issue log. Described in Section 4.3.3.3. New issues raised as a result of this process are recorded in the issue log. Risk register. Described in Section 11.2.3.1. New risks identified during this process are recorded in the risk register and managed using the risk management processes.
  • 569.
    13.2 PLAN STAKEHOLDERENGAGEMENT Plan Stakeholder Engagement is the process of developing approaches to involve project stakeholders based on their needs, expectations, interests, and potential impact on the project. The key benefit is that it provides an actionable plan to interact effectively with stakeholders. This process is performed periodically throughout the project as needed. The inputs, tools and techniques, and outputs of the process are depicted in Figure 13-4. Figure 13-5 depicts the data flow diagram for the process.
  • 570.
    An effective planthat recognizes the diverse information needs of the project's stakeholders is developed early in the project life cycle and is reviewed and updated regularly as the stakeholder community changes. The first version of the stakeholder engagement plan is developed after the initial stakeholder community has been identified by the Identify Stakeholder process. The stakeholder engagement plan is updated regularly to reflect changes to the stakeholder community. Typical trigger situations requiring updates to the plan include but are not limited to: When it is the start of a new phase of the project; When there are changes to the organization structure or within the industry;
  • 571.
    When new individualsor groups become stakeholders, current stakeholders are no longer part of the stakeholder community, or the importance of particular stakeholders to the project's success changes; and When outputs of other project process areas, such as change management, risk management, or issue management, require a review of stakeholder engagement strategies. The results of these adjustments may be changes to the relative importance of the stakeholders who have been identified. 13.2.1 PLAN STAKEHOLDER ENGAGEMENT: INPUTS 13.2.1.1 PROJECT CHARTER Described in Section 4.1.3.1. The project charter contains information on the project purpose, objectives, and success criteria that can be taken into consideration when planning how to engage stakeholders. 13.2.1.2 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan may contain information regarding roles and responsibilities of the team and other stakeholders listed in the stakeholder register. Communications management plan. Described in Section 10.1.3.1. The communications strategies for stakeholder management and their implementation plans are both inputs to, and recipients of, information from processes in Project Stakeholder Management. Risk management plan. Described in Section 11.1.3.1. The risk management plan may contain risk thresholds or risk attitudes that can assist in the selection of the optimal stakeholder engagement strategy mix. 13.2.1.3 PROJECT DOCUMENTS
  • 572.
    Project documents thatcan be considered as inputs for this process, especially after initial planning has taken place, include but are not limited to: Assumption log. Described in Section 4.1.3.2. The assumption log contains information about assumptions and constraints and may be linked to specific stakeholders. Change log. Described in Section 4.6.3.3. The change log contains changes to the original scope of the project. It usually links to specific stakeholders because they fall into categories of requesting certain changes, making decisions about change requests, or being impacted by the implementation of approved changes. Issue log. Described in Section 4.3.3.3. Managing and resolving issues contained in the issue log will require additional communications with the stakeholders affected. Project schedule. Described in Section 6.5.3.2. The schedule contains activities that may be linked to specific stakeholders as owners or executors. Risk register. Described in Section 11.2.3.1. The risk register contains the identified risks of the project and usually links them to the specific stakeholders as either risk owners or as subject to risk impact. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register provides the list of project stakeholders including additional classification data and other information. 13.2.1.4 AGREEMENTS Described in Section 12.2.3.2. When planning for the engagement of contractors and suppliers, coordination usually involves working with the procurement/contracting group in the organization to ensure contractors and suppliers are effectively managed. 13.2.1.5 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence Plan Stakeholder Engagement include but are not limited to: Organizational culture, political climate, and governance framework; Personnel administration policies;
  • 573.
    Stakeholder risk appetites; Establishedcommunication channels; Global regional or local trends, practices, or habits; and Geographic distribution of facilities and resources. 13.2.1.6 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Plan Stakeholder Engagement process include but are not limited to: Corporate policies and procedures for social media, ethics, and security; Corporate policies and procedures for issue, risk, change, and data management; Organizational communication requirements; Standardized guidelines for development, exchange, storage, and retrieval of information; Lessons learned repository with information about the preferences, actions, and involvement of stakeholders; and Software tools needed to support effective stakeholder engagement. 13.2.2 PLAN STAKEHOLDER ENGAGEMENT: TOOLS AND TECHNIQUES 13.2.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Politics and power structures in the organization and outside the organization, Environment and culture of the organization and outside the organization, Analytical and assessment techniques to be used for stakeholder engagement processes, Communication means and strategies, and
  • 574.
    Knowledge from previousprojects of the characteristics of stakeholders and stakeholder groups and organizations involved in the current project that may have been involved in previous similar projects. 13.2.2.2 DATA GATHERING A data-gathering technique that can be used for this process includes but is not limited to benchmarking. Described in Section 8.1.2.2. The results of stakeholder analysis are compared with information from other organizations or other projects that are considered to be world class. 13.2.2.3 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Assumption and constraint analysis. Described in Section 11.2.2.3. Analysis of current assumptions and constraints may be conducted in order to tailor appropriate engagement strategies. Root cause analysis. Described in Section 8.2.2.2. Root cause analysis identifies underlying reasons for the level of support of project stakeholders in order to select the appropriate strategy to improve their level of engagement. 13.2.2.4 DECISION MAKING Decision-making techniques that can be used for this process include but are not limited to prioritization/ranking. Stakeholder requirements need to be prioritized and ranked, as do the stakeholders themselves. Stakeholders with the most interest and the highest influence are often prioritized at the top of the list. 13.2.2.5 DATA REPRESENTATION Data representation techniques that may be used in this process include but are not limited to: Mind mapping. Described in Section 5.2.2.3. Mind mapping is used to visually organize information about stakeholders and their relationship to each other and the organization. Stakeholder engagement assessment matrix. A stakeholder
  • 575.
    engagement assessment matrixsupports comparison between the current engagement levels of stakeholders and the desired engagement levels required for successful project delivery. One way to classify the engagement level of stakeholders is shown in Figure 13-6. The engagement level of stakeholders can be classified as follows: Unaware. Unaware of the project and potential impacts. Resistant. Aware of the project and potential impacts but resistant to any changes that may occur as a result of the work or outcomes of the project. These stakeholders will be unsupportive of the work or outcomes of the project. Neutral. Aware of the project, but neither supportive nor unsupportive. Supportive. Aware of the project and potential impacts and supportive of the work and its outcomes. Leading. Aware of the project and potential impacts and actively engaged in ensuring that the project is a success. In Figure 13-6, C represents the current engagement level of each stakeholder and D indicates the level that the project team has assessed as essential to ensure project success (desired). The gap between current and desired for each stakeholder will direct the level of communications necessary to effectively engage the stakeholder. The closing of this gap between current and desired is an essential element of monitoring stakeholder engagement. 13.2.2.6 MEETINGS Meetings are used to discuss and analyze the input data of the stakeholder engagement planning process and to develop a sound stakeholder engagement plan. 13.2.3 PLAN STAKEHOLDER ENGAGEMENT: OUTPUTS
  • 576.
    13.2.3.1 STAKEHOLDER ENGAGEMENTPLAN The stakeholder engagement plan is a component of the project management plan that identifies the strategies and actions required to promote productive involvement of stakeholders in decision making and execution. It can be formal or informal and highly detailed or broadly framed, based on the needs of the project and the expectations of stakeholders. The stakeholder engagement plan may include but is not limited to specific strategies or approaches for engaging with individuals or groups of stakeholders. 13.3 MANAGE STAKEHOLDER ENGAGEMENT Manage Stakeholder Engagement is the process of communicating and working with stakeholders to meet their needs and expectations, address issues, and foster appropriate stakeholder involvement. The key benefit of this process is that it allows the project manager to increase support and minimize resistance from stakeholders. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 13-7. Figure 13-8 depicts the data flow diagram for the process.
  • 577.
    Manage Stakeholder Engagementinvolves activities such as: Engaging stakeholders at appropriate project stages to obtain, confirm, or maintain their continued commitment to the success of the project; Managing stakeholder expectations through negotiation and communication; Addressing any risks or potential concerns related to stakeholder management and anticipating future issues that may be raised by stakeholders; and Clarifying and resolving issues that have been identified. Managing stakeholder engagement helps to ensure that stakeholders clearly understand the project goals, objectives, benefits, and risks for the project, as well as how their contribution will enhance project success. 13.3.1 MANAGE STAKEHOLDER ENGAGEMENT: INPUTS 13.3.1.1 PROJECT MANAGEMENT PLAN
  • 578.
    Described in Section4.2.3.1. Project management plan components include but are not limited to: Communications management plan. Described in Section 10.1.3.1. The communications management plan describes the methods, formats, and technologies used for stakeholder communication. Risk management plan. Described in Section 11.1.3.1. The risk management plan describes the risk categories, risk appetites, and reporting formats that can be used to manage stakeholder engagement. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan provides guidance and information on managing stakeholder expectations. Change management plan. Described in Section 4.2.3.1. The change management plan describes the process for submitting, evaluating and implementing changes to the project. 13.3.1.2 PROJECT DOCUMENTS Project documents that can be considered as inputs to this process include but are not limited to: Change log. Described in Section 4.6.3.3. Change requests and their status are documented in the change log and communicated to the appropriate stakeholders. Issue log. Described in Section 4.3.3.3. Any project or stakeholder concerns are documented in the issue log, as well as any assigned action items associated with managing the issue. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project with regard to managing stakeholder engagement can be applied to later phases in the project to improve the efficiency and effectiveness of this process. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register provides the list of project stakeholders and any information needed to execute the stakeholder engagement plan. 13.3.1.3 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Manage Stakeholder Engagement include but are not limited to:
  • 579.
    Organizational culture, politicalclimate, and governance structure of the organization; Personnel administration policies; Stakeholder risk thresholds; Established communication channels; Global, regional, or local trends, practices, or habits; and Geographic distribution of facilities and resources. 13.3.1.4 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Manage Stakeholder Engagement process include but are not limited to: Corporate policies and procedures for social media, ethics, and security; Corporate policies and procedures for issue, risk, change, and data management; Organizational communication requirements; Standardized guidelines for development, exchange, storage, and retrieval of information; and Historical information from previous similar projects. 13.3.2 MANAGE STAKEHOLDER ENGAGEMENT: TOOLS AND TECHNIQUES 13.3.2.1 EXPERT JUDGMENT Described in Section 4.1.2.1. Expertise should be considered from individuals or groups with specialized knowledge or training in the following topics: Politics and power structures in the organization and outside the organization; Environment and culture of the organization and outside the organization; Analytical and assessment techniques to be used for stakeholder engagement processes;
  • 580.
    Communication methods andstrategies; Characteristics of stakeholders, stakeholder groups, and organizations involved in the current project that may have been involved in previous projects; and Requirements management, vendor management, and change management. 13.3.2.2 COMMUNICATION SKILLS The methods of communication identified for each stakeholder in the communications management plan are applied during stakeholder engagement management. The project management team uses feedback to assist in understanding stakeholder reaction to the various project management activities and key decisions. Feedback may be collected in the following ways, but not limited to: Conversations; both formal and informal, Issue identification and discussion, Meetings, Progress reporting, and Surveys. 13.3.2.3 INTERPERSONAL AND TEAM SKILLS Interpersonal and team skills that can be used for this process include but are not limited to: Conflict management. Described in Section 9.5.2.1. The project manager should ensure that conflicts are resolved in a timely manner. Cultural awareness. Described in Section 10.1.2.6. Cultural awareness is used to help the project manager and team to communicate effectively by considering cultural differences and the requirements of stakeholders. Negotiation. Described in Section 12.2.2.5. Negotiation is used to achieve support or agreement that supports the work of the project or its outcomes and to resolve conflicts within the team or with other stakeholders.
  • 581.
    Observation/conversation. Described inSection 5.2.2.6. Observation/conversation is used to stay in touch with the work and attitudes of project team members and other stakeholders. Political awareness. Described in Section 10.1.2.6. Political awareness is achieved through understanding the power relationships within and around the project. 13.3.2.4 GROUND RULES Ground rules, defined in the team charter set the expected behavior for project team members, as well as other stakeholders, with regard to stakeholder engagement. 13.3.2.5 MEETINGS Described in Section 10.1.2.8. Meetings are used to discuss and address any issue or concern regarding stakeholder engagement. Types of meetings that are beneficial as part of this process include but are not limited to: Decision making, Issue resolution, Lessons learned and retrospectives, Project kick-off, Sprint planning, and Status updates. 13.3.3 MANAGE STAKEHOLDER ENGAGEMENT: OUTPUTS 13.3.3.1 CHANGE REQUESTS Described in Section 4.3.3.4. As a result of managing stakeholder engagement, changes to the project scope or product scope may emerge. All change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 13.3.3.2 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's
  • 582.
    change control processvia a change request. Components of the project management plan that may require a change request for the project management plan include but are not limited to: Communications management plan. Described in Section 10.1.3.1. The communications management plan is updated to reflect new or changed stakeholder requirements. Stakeholder engagement plan. Described in Section 13.2.3.1. The stakeholder engagement plan is updated to reflect new or changed management strategies required to effectively engage stakeholders. 13.3.3.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Change log. Described in Section 4.6.3.3. The change log may be updated based on any change requests. Issue log. Described in Section 4.3.3.3. The issue log may be updated to reflect an update to, or the development of, an issue log entry. Lessons learned register. Described in Section 4.4.3.1. The lessons learned register is updated with effective or ineffective approaches to managing stakeholder engagement so that information can be used in the current project or future projects. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register may be updated based on new information provided to stakeholders about resolved issues, approved changes, and general project status. 13.4 MONITOR STAKEHOLDER ENGAGEMENT Monitor Stakeholder Engagement is the process of monitoring project stakeholder relationships and tailoring strategies for engaging stakeholders through modification of engagement strategies and plans. The key benefit of this process is that it maintains or increases the efficiency and effectiveness of stakeholder engagement activities as the project evolves and its environment changes. This process is performed throughout the project. The inputs, tools and techniques, and outputs of the process are depicted in Figure 13-9. Figure 13-10
  • 583.
    depicts the dataflow diagram for the process.
  • 584.
    13.4.1 MONITOR STAKEHOLDERENGAGEMENT: INPUTS 13.4.1.1 PROJECT MANAGEMENT PLAN Described in Section 4.2.3.1. Project management plan components include but are not limited to: Resource management plan. Described in Section 9.1.3.1. The resource management plan identifies the methods for team member management. Communications management plan. Described in Section 10.1.3.1. The communications management plan describes the plans and strategies for communication to the project's stakeholders. Stakeholder engagement plan. Described in Section 13.2.3.1. Defines the plan for managing stakeholder needs and expectations.
  • 585.
    13.4.1.2 PROJECT DOCUMENTS Projectdocuments that can be considered as inputs for this process include but are not limited to: Issue log. Described in Section 4.3.3.3. The issue log documents all the known issues related to the project and stakeholders. Lessons learned register. Described in Section 4.4.3.1. Lessons learned earlier in the project can be applied in later phases of the project to improve the efficiency and effectiveness of engaging stakeholders. Project communications. Described in Section 10.2.3.1. These include the project communications that have been distributed to stakeholders as defined in the communications management plan and the stakeholder engagement plan. Risk register. Described in Section 11.2.3.1. The risk register contains the identified risks for the project, including those related to stakeholder engagement and interactions, their categorization, and list of potential responses. Stakeholder register. Described in Section 13.1.3.1. The stakeholder register contains stakeholder information that includes but is not limited to stakeholder identification, assessment, and classification. 13.4.1.3 WORK PERFORMANCE DATA Described in Section 4.3.3.2. Work performance data contains data on project status such as which stakeholders are supportive of the project, and their level and type of engagement. 13.4.1.4 ENTERPRISE ENVIRONMENTAL FACTORS The enterprise environmental factors that can influence the Monitor Stakeholder Engagement process include but are not limited to: Organizational culture, political climate, and governance framework; Personnel administration policies; Stakeholder risk thresholds; Established communication channels; Global, regional, or local trends, practices, or habits; and
  • 586.
    Geographic distribution offacilities and resources. 13.4.1.5 ORGANIZATIONAL PROCESS ASSETS The organizational process assets that can influence the Monitor Stakeholder Engagement process include but are not limited to: Corporate policies and procedures for social media, ethics, and security; Corporate policies and procedures for issue, risk, change, and data management; Organizational communication requirement; Standardized guidelines for development, exchange, storage, and retrieval of information; and Historical information from previous projects. 13.4.2 MONITOR STAKEHOLDER ENGAGEMENT: TOOLS AND TECHNIQUES 13.4.2.1 DATA ANALYSIS Data analysis techniques that can be used for this process include but are not limited to: Alternatives analysis. Described in Section 9.2.2.5. Alternatives analysis can be used to evaluate options to respond to variances in the desired results of stakeholder engagement. Root cause analysis. Described in Section 8.2.2.2. A root cause analysis can be used to determine the basic underlying reason that stakeholder engagement is not having the planned effect. Stakeholder analysis. Described in Section 13.1.2.3. The stakeholder analysis helps to determine the position of stakeholder groups and individuals at any particular time in the project. 13.4.2.2 DECISION MAKING Decision-making techniques that can be used for this process include but are not limited to:
  • 587.
    Multicriteria decision analysis.Described in Section 8.1.2.4. Criteria for successful stakeholder engagement are prioritized and weighted to identify the most appropriate choice. Voting. Described in Section 5.2.2.4. Voting can be used to select the best response for a variance in stakeholder engagement. 13.4.2.3 DATA REPRESENTATION A data representation technique used in this process includes but is not limited to a stakeholder engagement assessment matrix. Described in Section 13.2.2.3. The stakeholder engagement assessment matrix monitors stakeholder engagement through tracking changes in level of engagement for each stakeholder. 13.4.2.4 COMMUNICATION SKILLS Communication techniques that can be used for this process include but are not limited to: Feedback. Described in Section 10.2.2.3. Feedback is used to ensure that the information to stakeholders is received and understood. Presentations. Described in Section 10.2.2.3. Presentations provide clear information to stakeholders. 13.4.2.5 INTERPERSONAL AND TEAM SKILLS Interpersonal skills to that can be used for this process include but are not limited to: Active listening. Described in Section 10.2.2.6. Active listening is used to reduce misunderstandings and other miscommunication. Cultural awareness. Described in Section 10.1.2.6. Cultural awareness and cultural sensitivity help the project manager to plan communications based on the cultural differences and requirements of stakeholders and team members. Leadership. Described in Section 3.4.4. Successful stakeholder engagement requires strong leadership skills to communicate the vision and inspire stakeholders to support the work and outcomes of the project.
  • 588.
    Networking. Described inSection 10.2.2.6. Networking ensures access to information about levels of engagement of stakeholders. Political awareness. Described in Section 10.1.2.6. Political awareness is used to understand the strategies of the organization, understand who wields power and influence in this arena, and to develop an ability to communicate with these stakeholders. 13.4.2.6 MEETINGS Types of meetings include status meetings, standup meetings, retrospectives, and any other meetings as agreed upon in the stakeholder engagement plan to monitor and assess stakeholder engagement levels. Meetings are no longer limited by face-to-face or voice-to-voice interactions. While face-to-face interactions are ideal, they can be expensive. Teleconferencing and technology bridge the gap and provide numerous ways to connect and conduct a meeting. 13.4.3 MONITOR STAKEHOLDER ENGAGEMENT: OUTPUTS 13.4.3.1 WORK PERFORMANCE INFORMATION Described in Section 4.5.1.3. Work performance information includes information about the status of stakeholder engagement, such as the level of current project support and compared to the desired levels of engagement as defined in the stakeholder engagement assessment matrix, stakeholder cube, or other tool. 13.4.3.2 CHANGE REQUESTS Described in Section 4.3.3.4. A change request may include corrective and preventive actions to improve the current level of stakeholder engagement. Change requests are processed for review and disposition through the Perform Integrated Change Control process (Section 4.6). 13.4.3.3 PROJECT MANAGEMENT PLAN UPDATES Any change to the project management plan goes through the organization's change control process via a change request. Components of the project management plan that may require a change request include but are not limited to:
  • 589.
    Resource management plan.Described in Section 9.1.3.1. Team responsibilities for stakeholder engagement activities may need to be updated. Communications management plan. Described in Section 10.1.3.1. The project's communication strategies may need to be updated. Stakeholder engagement plan. Described in Section 13.2.3.1. Information about the project's stakeholder community may need to be updated. 13.4.3.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of carrying out this process include but are not limited to: Issue log. Described in Section 4.3.3.3. Information in the issue log indicates stakeholder attitudes and may need to be updated. Lessons learned register. Described in Section 4.3.3.1. The lessons learned register is updated with information on challenges and how they could have been avoided. It is also updated with approaches that worked well for engaging stakeholders optimally, and those that did not work well. Risk register. Described in Section 11.2.3.1. The risk register may need to be updated with responses to stakeholder risks. Stakeholder register. Described in Section 13.1.12-13.1. The stakeholder register is updated with information as a result of monitoring stakeholder engagement.
  • 590.
    REFERENCES [1] Project ManagementInstitute. 2017. The Standard for Project Management. Newtown Square, PA: Author. [2] Project Management Institute. 2013. The Standard for Portfolio Management – Third Edition. Newtown Square, PA: Author. [3] Project Management Institute. 2017. The Standard for Program Management – Fourth Edition. Newtown Square, PA: Author. [4] Project Management Institute. 2016. The PMI Lexicon of Project Management Terms. Available from http://www.pmi.org/lexiconterms [5] Project Management Institute. Code of Ethics and Professional Conduct. Available from http://www.pmi.org/codeofethics [6] Project Management Institute. 2013. Managing Change in Organizations: A Practice Guide. Newtown Square, PA: Author. [7] Project Management Institute. 2015. Business Analysis for Practitioners: A Practice Guide. Newtown Square, PA: Author. [8] Project Management Institute. 2014. Implementing Organizational Project Management: A Practice Guide. Newtown Square, PA: Author. [9] Project Management Institute. 2014. Project Management Institute Excellence in Practice-Research Collaboration, PMI-RI Standards Program: Making Sense of PPP Governance, December 19, 2014. Newtown Square, PA: Author [10] Project Management Institute. 2016. Governance of Portfolios, Programs, and Projects: A Practice Guide. Newtown Square, PA: Author. [11] Project Management Institute. (2013). PMI's Pulse of the Profession® In-Depth Report: The Competitive Advantage of Effective Talent Management. Available from http://www.pmi.org [12] Project Management Institute. 2015. White Paper, Complexity Management for Projects, Programmes, and Portfolios: An Engineering Systems Perspective, March 2015. Newtown Square, PA: Author. [13] Project Management Institute. 2014. Navigating Complexity: A Practice Guide. Newtown Square, PA: Author.
  • 591.
    [14] Project ManagementInstitute. 2016. Requirements Management: A Practice Guide. Newtown Square, PA: Author. [15] Project Management Institute. 2006. Practice Standard for Work Breakdown Structures (WBS). Newtown Square, PA: Author. [16] Project Management Institute. 2011. Practice Standard for Scheduling – Second Edition. Newtown Square, PA: Author. [17] Project Management Institute. 2011. Practice Standard for Earned Value Management – Second Edition [18] International Standards Organization. 2015. ISO 9000:2015 Quality Management Systems—Fundamentals and Vocabulary. Geneva: Author.
  • 592.
    Part 2 The Standardfor Project Management
  • 593.
    1 INTRODUCTION A standard isa document established by an authority, custom, or general consent as a model or example. This standard was developed using a process based on the concepts of consensus, openness, due process, and balance. This standard describes the processes considered to be good practice on most projects most of the time. These processes are organized by Process Group. It further defines key project management concepts including the relationship of project management to organizational strategy and objectives, governance, portfolio management, program management, the project environment, and project success. It also covers information on project life cycles, project stakeholders, and the role of the project manager. Section 1 discusses key concepts and provides contextual information about project management. Sections 2 through 6 provide definitions for each of the five Process Groups and describe the processes within those Process Groups. Sections 2 through 6 also describe the key benefits, inputs, and outputs for each project management process. This standard serves as the foundation and framework for A Guide to the Project Management Body of Knowledge (PMBOK® Guide).1 PMBOK® Guide expands on the information in this standard by providing a more in-depth description of the context, environment and influences on project management. In addition, the PMBOK® Guide provides descriptions of the project management process inputs and outputs, identifies tools and techniques, and discusses key concepts and emerging trends associated with each Knowledge Area. 1.1 PROJECTS AND PROJECT MANAGEMENT A project is a temporary endeavor undertaken to create a unique product, service, or result. The temporary nature of projects indicates a definite beginning and end. Temporary does not necessarily mean a project has a short duration. A project's end is reached when the objectives have been achieved or when the
  • 594.
    project is terminatedbecause its objectives will not or cannot be met, or when the need for the project no longer exists. The decision to terminate a project requires approval and authorization by an appropriate authority. Project management is the application of knowledge, skills, tools, and techniques to project activities to meet project requirements. Project management is accomplished through the appropriate application and integration of the project management processes identified for the project. Managing a project typically includes but is not limited to: Identifying project requirements; Addressing the various needs, concerns, and expectations of stakeholders; Establishing and maintaining active communication with stakeholders; Managing resources; and Balancing the competing project constraints, which include but are not limited to: Scope, Schedule, Cost, Quality, Resources, and Risk. Project circumstances will influence how each project management process is implemented and how the project constraints are prioritized. 1.2 RELATIONSHIPS AMONG PORTFOLIOS, PROGRAMS, AND PROJECTS A portfolio is defined as projects, programs, subsidiary portfolios, and operations managed in a coordinated manner to achieve strategic objectives. Portfolio management is the centralized management of one or more portfolios to achieve strategic objectives. Portfolio management focuses on ensuring the portfolio is performing consistent with the organization's objectives and evaluating portfolio components to optimize resource allocation. Portfolios may
  • 595.
    include work thatis operational in nature. A program is defined as related projects, subsidiary programs, and program activities managed in a coordinated manner to obtain benefits not available from managing them individually. Programs include program related work outside the scope of the discrete projects in the program. Program management is the application of knowledge, skills, and principles to a program to achieve the program objectives and to obtain benefits and control not available by managing related program components individually. Programs may also include work that is operational in nature. Program management supports organizational strategies by authorizing, changing, or terminating projects and managing their interdependencies. Managing project interdependencies may include, among other actions, the following: Resolving resource constraints and/or conflicts that affect components within the program; Aligning with the organization's strategies that impact and affect program goals and objectives Managing issues and employing change management within a shared governance structure; Addressing project and program risks that can impact one or more components; and Managing program benefits realization by effectively analyzing, sequencing and monitoring component interdependencies. A project may be managed in three separate scenarios: as a stand-alone project (outside a portfolio or program); within a program; or within a portfolio. Project management has interactions with portfolio and program management when a project is within a portfolio or program. Figure 1-1 illustrates a sample portfolio structure indicating relationships of the components, shared resources and stakeholders. The portfolio components are grouped together in order to facilitate the effective governance and management of that work and to achieve organizational strategies and priorities. Organizational and portfolio planning impact the components by means of prioritization based on risk, funding, and other considerations. This allows organizations to have an overall view of how the strategic goals are reflected in the portfolio; institute appropriate portfolio, program, and project governance; and authorize human, financial, or physical resources. These resources will be
  • 596.
    allocated based onexpected performance and benefits. Figure 1-1 illustrates that organizational strategies and priorities are linked and have relationships between portfolios and programs, between portfolios and projects, and between programs and individual projects. These relationships are not always strictly hierarchical. Organizational project management (OPM) is a strategy execution framework utilizing portfolio, program, and project management. It provides a framework that enables organizations to consistently and predictably deliver on organizational strategy, producing better performance, better results, and a sustainable competitive advantage. 1.3 LINKING ORGANIZATIONAL GOVERNANCE AND PROJECT GOVERNANCE There are various types of governance including organizational governance; organizational project management (OPM) governance; and portfolio, program, and project governance. Organizational governance is a structured way to provide direction and control through policies, and processes, to meet strategic and operational goals. Organizational governance is typically conducted by a board of directors to ensure accountability, fairness, and transparency to its
  • 597.
    stakeholders. Organizational governanceprinciples, decisions, and processes may influence and impact the governance of portfolios, programs, and projects in the following ways: Enforcing legal, regulatory, standards, and compliance requirements, Defining ethical, social, and environmental responsibilities, and Specifying operational, legal, and risk policies. Project governance is the framework, functions, and processes that guide project management activities in order to create a unique product, service, or result to meet organizational, strategic, and operational goals. Governance at the project level includes: Guiding and overseeing the management of project work; Ensuring adherence to policies, standards, and guidelines; Establishing governance roles, responsibilities, and authorities; Decision-making regarding risk escalations, changes, and resources (e.g. team, financial, physical, facilities); Ensuring appropriate stakeholder engagement; and Monitoring performance. The project governance framework provides the project stakeholders with structure, processes, roles, responsibilities, accountabilities, and decision-making models for managing the project. Elements of a project governance framework include but are not limited to principles or processes for: Stage gate or phase reviews; Identifying, escalating, and resolving risks and issues; Defining roles, responsibilities, and authorities; Process for project knowledge management and capturing lessons learned; Decision making, problem solving and escalating topics that are beyond the project manager's authority; and Reviewing and approving changes to project, and product changes that are beyond the authority of the project manager.
  • 598.
    1.4 PROJECT SUCCESSAND BENEFITS MANAGEMENT Projects are initiated to realize business opportunities that are aligned with an organization's strategic goals. Prior to initiating a project, a business case is often developed to outline the project objectives, the required investment, and financial and qualitative criteria for project success. The business case provides the basis to measure success and progress throughout the project life cycle by comparing the results with the objectives and the identified success criteria. Projects are typically initiated as a result of one or more of the following strategic considerations: Market demand, Strategic opportunity/business need, Social need, Environmental consideration, Customer request, Technological advancement, Legal or regulatory requirement, and Existing or forecasted problem. A benefits management plan describes how and when the benefits of the project will be delivered and how they will be measured. The benefits management plan may include the following: Target benefits. The expected tangible and intangible business value to be gained by the implementation of the product, service, or result. Strategic alignment. How the project benefits support and align with the business strategies of the organization. Timeframe for realizing benefits. Benefits by phase: short term, long term, and ongoing. Benefits owner. The accountable person or group that monitors, records, and reports realized benefits throughout the timeframe established in the plan. Metrics. The direct and indirect measurements used to show the benefits realized. Risks. Risks associated with achieving target benefits.
  • 599.
    The success ofthe project is measured against the project objectives and success criteria. In many cases, the success of the product, service, or result is not known until sometime after the project is complete. For example, an increase in market share, a decrease in operating expenses, or the success of a new product may not be known when the project is transitioned to operations. In these circumstances, the project management office (PMO), portfolio steering committee, or some other business function within the organization should evaluate the success at a later date to determine if the outcomes met the business objectives. Both the business case and the benefits management plan are developed prior to the project being initiated. Additionally, both documents are referenced after the project has been completed. Therefore, they are considered business documents rather than project documents or components of the project management plan. As appropriate, these business documents may be inputs to some of the processes involved in managing the project, such as developing the project charter. 1.5 THE PROJECT LIFE CYCLE A project life cycle is the series of phases that a project passes through from its start to its completion. A project phase is a collection of logically related project activities that culminates in the completion of one or more deliverables. The phases can be sequential, iterative, or overlapping. The names, number, and duration of the project phases are determined by the management and control needs of the organization(s) involved in the project, the nature of the project itself, and its area of application. Phases are time bound, with a start and end or control point (sometimes referred to as a phase review, phase gate, control gate, or other similar term). At the control point, the project charter and business documents are reexamined based on the current environment. At that time, the project's performance is compared to the project management plan to determine if the project should be changed, terminated, or continue as planned. The project life cycle can be influenced by the unique aspects of the organization, industry, development method, or technology employed. While every project has a start and end, the specific deliverables and work that take place vary widely depending on the project. The life cycle provides the basic framework for managing the project, regardless of the specific work involved. Though projects vary in size and the amount of complexity they contain, a
  • 600.
    typical project canbe mapped to the following project life cycle structure (see Figure 1-2): Starting the project, Organizing and preparing, Carrying out the work, and Closing the project. A generic life cycle structure typically displays the following characteristics: Cost and staffing levels are low at the start, increase as the work is carried out, and drop rapidly as the project draws to a close. Risk is greatest at the start of the project as illustrated by Figure 1-3. These factors decrease over the life cycle of the project as decisions are reached and as deliverables are accepted. The ability of stakeholders to influence the final characteristics of the project's product, without significantly impacting cost and schedule, is highest at the start of the project and decreases as the project progresses toward completion. Figure 1-3 illustrates the cost of making changes and correcting errors typically increases substantially as the project approaches completion.
  • 601.
    1.6 PROJECT STAKEHOLDERS Astakeholder is an individual, group, or organization that may affect, be affected by, or perceive itself to be affected by a decision, activity, or outcome of a project. Project stakeholders may be internal or external to the project, they may be actively involved, passively involved, or unaware of the project. Project stakeholders may have a positive or negative impact on the project, or be positively or negatively impacted by the project. Examples of stakeholders include but are not limited to: Internal stakeholders: Sponsor, Resource manager, Project management office (PMO), Portfolio steering committee, Program manager, Project managers of other projects, and Team members. External stakeholders:
  • 602.
    Customers, End users, Suppliers, Shareholders Regulatory bodies,and Competitors Figure 1-4 shows examples of project stakeholders. Stakeholder involvement may range from occasional contributions in surveys and focus groups to full project sponsorship that includes the provision of financial, political, or other types of support. The type and level of project involvement can change over the course of the project's life cycle. Therefore, successfully identifying, analyzing, and engaging stakeholders and effectively managing their project expectations
  • 603.
    and participation throughoutthe project life cycle is critical to project success. 1.7 ROLE OF THE PROJECT MANAGER The project manager is the person assigned by the performing organization to lead the team responsible for achieving the project objectives. The project manager's reporting relationships are based on the organizational structure and project governance. In addition to any specific technical skills and general management proficiencies required for the project, project managers should have at least the following attributes: Knowledge about project management, the business environment, technical aspects, and other information needed to manage the project effectively; Skills needed to effectively lead the project team, coordinate the work, collaborate with stakeholders, solve problems, and make decisions; Abilities to develop and manage scope, schedules, budgets, resources, risks, plans, presentations, and reports; and Other attributes required to successfully manage the project, such as personality, attitude, ethics, and leadership. Project managers accomplish work through the project team and other stakeholders. Project managers rely on important interpersonal skills, including, but not limited to: Leadership, Team building, Motivating, Communicating, Influencing, Decision making, Political and cultural awareness, Negotiating, Facilitating, Managing conflict, and
  • 604.
    Coaching. The project manageris successful when the project objectives have been achieved. Another aspect of success is stakeholder satisfaction. The project manager should address stakeholder needs, concerns and expectations to satisfy relevant stakeholders. To be successful, the project manager should tailor the project approach, life cycle, and project management processes to meet the project and product requirements. 1.8 PROJECT MANAGEMENT KNOWLEDGE AREAS The Project Management Knowledge Areas are fields or areas of specialization that are commonly employed when managing projects. A Knowledge Area is a set of processes associated with a particular topic in project management. These 10 Knowledge Areas are used on most projects most of the time. The needs of a specific project may require additional Knowledge Areas. The 10 Knowledge Areas are: Project Integration Management. Project Integration Management includes the processes and activities to identify, define, combine, unify, and coordinate the various processes and project management activities within the Project Management Process Groups. Project Scope Management. Project Scope Management includes the processes required to ensure that the project includes all the work required, and only the work required, to complete the project successfully. Project Schedule Management. Project Schedule Management includes the processes required to manage the timely completion of the project. Project Cost Management. Project Cost Management includes the processes involved in planning, estimating, budgeting, financing, funding, managing, and controlling costs so the project can be completed within the approved budget. Project Quality Management. Project Quality Management includes the processes for incorporating the organization's quality policy regarding planning, managing, and controlling project and product quality requirements, in order to meet stakeholders’ expectations.
  • 605.
    Project Resource Management.Project Resource Management includes the processes to identify, acquire, and manage the resources needed for the successful completion of the project. Project Communications Management. Project Communications Management includes the processes required to ensure timely and appropriate planning, collection, creation, distribution, storage, retrieval, management, control, monitoring, and ultimate disposition of project information. Project Risk Management. Project Risk Management includes the processes of conducting risk management planning, identification, analysis, response planning, response implementation, and monitoring risk on a project. Project Procurement Management. Project Procurement Management includes the processes necessary to purchase or acquire products, services, or results needed from outside the project team. Project Stakeholder Management. Project Stakeholder Management includes the processes required to identify the people, groups, or organizations that could impact or be impacted by the project, to analyze stakeholder expectations and their impact on the project, and to develop appropriate management strategies for effectively engaging stakeholders in project decisions and execution. 1.9 PROJECT MANAGEMENT PROCESS GROUPS This standard describes the project management processes employed to meet project objectives. Project management processes are grouped in five Project Management Process Groups: Initiating Process Group. The process(es) performed to define a new project or a new phase of an existing project by obtaining authorization to start the project or phase. Initiating processes are described in Section 2. Planning Process Group. The process(es) required to establish the scope of the project, refine the objectives, and define the course of action required to attain the objectives that the project was undertaken to achieve. Planning processes are described in Section 3.
  • 606.
    Executing Process Group.The process(es) performed to complete the work defined in the project management plan to satisfy the project requirements. Executing processes are described in Section 4. Monitoring and Controlling Process Group. The process(es) required to track, review, and regulate the progress and performance of the project; identify any areas in which changes to the plan are required; and initiate the corresponding changes. Monitoring and Controlling processes are described in Section 5. Closing Process Group. The process(es) performed to formally complete or close a project, phase, or contract. Closing processes are described in Section 6. These five Process Groups are independent of the application areas, (such as marketing, information services, or accounting) or industry focus (such as construction, aerospace, telecommunications). Individual processes in the Process Groups are often iterated prior to completing a phase or a project. The number of process iterations and interactions between processes varies based on the needs of the project. Processes generally fall into one of three categories: Processes used once or at predefined points in the project. Developing the project charter and closing the project or phase are examples. Processes that are performed periodically as needed. Acquiring resources is performed when resources are needed. Conducting procurements will be performed prior to needing the procured item. Processes that are performed continuously throughout the project. Defining activities may occur throughout the project life cycle, especially when the project uses rolling wave planning or an adaptive development approach. Many of the monitoring and control processes are ongoing from the start of the project, until it is closed out. The output of one process generally becomes an input to another process or is a deliverable of the project or project phase. For example, the project management plan and project documents (e.g., risk register, responsibility assignment matrix, etc.) produced in the Planning Process Group are provided to the Executing Process Group where updates are made. Figure 1-4 illustrates an example of how Process Groups can overlap during a project or phase. Process Groups are not project phases. If the project is divided into phases, the processes in the Process Groups interact within each phase. It is possible that all Process Groups could be represented within a phase, as illustrated in Figure 1-5.
  • 607.
    As projects areseparated into distinct phases, such as concept development, feasibility study, design, prototype, build, or test, etc., processes in each of the Process Groups are repeated as necessary in each phase until the completion criteria for that phase have been satisfied. Table 1-1 shows the 49 processes mapped to the Process Groups and Knowledge Areas.
  • 608.
    1.10 ENTERPRISE ENVIRONMENTALFACTORS AND ORGANIZATIONAL PROCESS ASSETS Projects exist and operate in environments that may have an influence on them. These influences can have a favorable or unfavorable impact on the project. Two major categories of influences are enterprise environmental factors (EEFs) and organizational process assets (OPAs). EEFs originate from the environment outside of the project and often outside of the enterprise. These factors refer to conditions, which are not under the control of the project team, that influence, constrain, or direct the project. EEFs
  • 609.
    may have animpact at the enterprise, portfolio, program, or project level. (Refer to Section 2.2 in the PMBOK® Guide for additional information on EEFs.) One set of such factors are the internal organizational culture, structure and governance. Examples in this area include but are not limited to: vision, mission, values, beliefs, cultural norms, hierarchy, and authority relationships. OPAs are internal to the enterprise. These may arise from the enterprise itself, a portfolio, a program, another project, or a combination of these. OPAs are the plans, processes, policies, procedures, and knowledge bases specific to and used by the performing organization. These assets influence the management of the project. Examples include but are not limited to: change control procedures, templates, information from previous projects, and lessons learned repositories. (Refer to Section 2.3 in the PMBOK® Guide for additional information on OPAs). 1.11 TAILORING THE PROJECT ARTIFACTS The term artifact in this context includes project management processes, inputs, tools, techniques, outputs, EEFs, and OPAs. The project manager and the project management team select and adapt the appropriate artifacts for use on their specific project. This selection and adaptation activity is known as tailoring. Tailoring is necessary because each project is unique; therefore, not every process, input, tool, technique, or output is required on every project. The project management plan is the most prevalent artifact. It has many components, such as the subsidiary management plans, baselines, and a description of the project life cycle. Subsidiary management plans are plans associated with a specific aspect or Knowledge Area of the project, for example, a schedule management plan, risk management plan and change management plan. Part of tailoring is identifying the project management plan components needed for a particular project. The project management plan is an input and project management plan updates are an output of many processes in this standard. Rather than listing the individual project management plan components in the input/output tables, examples of the components that may be inputs or may be updated as outputs are listed beneath the input/output tables for each process. The possible components are listed as examples only. These inputs and outputs are not required and are not the only inputs or updates to the project management plan that a project manager may use in that particular process. The project management plan is one of the primary project artifacts, but there
  • 610.
    are other documentsthat are not part of the project management plan that are used to manage the project. These other documents are called project documents. Similar to project management plan components, project documents needed for a process will depend on the individual project. The project manager is accountable for identifying the project documents needed for a process and the project documents that will be updated as an output of a process. The project documents listed beneath the input/output tables throughout this standard are possible examples of project documents, not a comprehensive list. Table 1-2 is a representative list of project management plan components and project documents. It is not complete list, but it does provide a representation of the types of documents that are often used to help manage a project. Table 1-2. Project Management Plan and Project Documents Project Management Plan Project Documents 1. Scope management plan 1. Activity attributes 19. Quality control measurements 2. Requirements management plan 2. Activity list 20. Quality metrics 3. Schedule management plan 3. Assumption log 21. Quality report 4. Cost management plan 4. Basis of estimates 22. Requirements documentation 5. Quality management plan 5. Change log 23. Requirements traceability matrix 6. Resource management plan 6. Cost estimates 24. Resource breakdown structure 7. Communications management plan 7. Cost forecasts 25. Resource calendars 8. Risk management plan 8. Duration estimates 26. Resource requirements 9. Procurement management plan 9. Issue log 27. Risk register 10. Stakeholder engagement plan 10. Lessons learned register 28. Risk report 11. Change management plan 11. Milestone list 29. Schedule data 12. Configuration management plan 12. Physical resource assignments 30. Schedule forecasts 13. Scope baseline 13. Project calendars 31. Stakeholder register 14. Schedule baseline 14. Project communications 32. Team charter
  • 611.
    15. Cost baseline15. Project schedule 33. Test and evaluation documents 16. Performance measurement baseline 16. Project schedule network diagram 17. Project life cycle description 17. Project scope statement 18. Development approach 18. Project team assignments Business documents are documents that are generally originated outside of the project, and are used as inputs to the project. Examples of business documents include the business case and benefits management plan. The use of the business documents will depend on the company culture and project initiation process. The enterprise environmental factors that influence the project and the organizational process assets available to the project will depend on the project and project environment and are not listed in this standard. 1 Project Management Institute. 2017. A Guide to the Project Management Body of Knowledge (PMBOK® Guide). Newtown Square, PA: Author.
  • 612.
    2 INITIATING PROCESS GROUP TheInitiating Process Group consists of those processes performed to define a new project or a new phase of an existing project by obtaining authorization to start the project or phase. The purpose of the Initiating Process Group is to align the stakeholders’ expectations and the project purpose, inform stakeholders of the scope and objectives, and discuss how their participation in the project and its associated phases can help to ensure their expectations are met. Within the Initiating processes, the initial scope is defined and initial financial resources are committed. Stakeholders who will interact and influence the overall outcome of the project are identified. If not already assigned, the project manager is appointed. This information is captured in the project charter and stakeholder register. When the project charter is approved, the project is officially authorized, and the project manager is authorized to apply organizational resources to project activities. The key benefits of this Process Group are that only projects that are aligned with the organization's strategic objectives are authorized and that the business case, benefits, and stakeholders are considered from the start of the project. In some organizations, the project manager is involved in developing the business case and defining the benefits. In those organizations, the project manager generally helps write the project charter; in other organizations, the pre-project work is done by the project sponsor, project management office (PMO), portfolio steering committee, or other stakeholder group. This standard assumes the project has been approved by the sponsor or other governing body and they have reviewed the business documents prior to authorizing the project. Business documents are documents that are generally originated outside of the project, but are used as input to the project. Examples of business documents include the business case, and benefits management plan. Figure 2-1 shows the sponsor and the business documents in relation to the Initiating Processes.
  • 613.
    As described inSection 1.5, projects are often divided into phases. When this is done, information from processes in the Initiating Process Group is reexamined to determine if the information is still valid. Revisiting the Initiating processes at the start of each phase helps keep the project focused on the business need that the project was undertaken to address. The project charter, business documents, and success criteria are verified. The influence, drivers, expectations, and objectives of the project stakeholders are reviewed. Involving the sponsors, customers, and other stakeholders during initiation creates a shared understanding of success criteria. It also increases the likelihood of deliverable acceptance when the project is complete, and stakeholder satisfaction throughout the project. The Initiating Process Group includes the project management processes identified in Sections 2.1 through 2.2.
  • 614.
    2.1 DEVELOP PROJECTCHARTER Develop Project Charter is the process of developing a document that formally authorizes the existence of a project and provides the project manager with the authority to apply organizational resources to project activities. The key benefits of this process are that it provides a direct link between the project and the strategic objectives of the organization, creates a formal record of the project, and shows the organizational commitment to the project. This process is performed once, or at predefined points in the project. The inputs and outputs of this process are shown in Figure 2-3. 2.2 IDENTIFY STAKEHOLDERS Identify Stakeholders is the process of identifying project stakeholders regularly and analyzing and documenting relevant information regarding their
  • 615.
    interests, involvement, interdependencies,influence, and potential impact on project success. The key benefit of this process is that it enables the project team to identify the appropriate focus for engagement of each stakeholder or group of stakeholders. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 2-4. The needs of the project determine which components of the project management plan and which project documents are necessary. 2.2.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Communications management plan, and Stakeholder engagement plan. 2.2.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Change log, Issue log, and Requirements documentation. 2.2.3 PROJECT MANAGEMENT PLAN UPDATES
  • 616.
    Examples of projectmanagement plan components that may be updated as a result of this process include but are not limited to: Requirements management plan, Communications management plan, Risk management plan, and Stakeholder engagement plan. 2.2.4 PROJECT DOCUMENTS UPDATES Examples of project documents that may be updated as a result of this process include but are not limited to: Assumption log, Issue log, and Risk register.
  • 617.
    3 PLANNING PROCESS GROUP ThePlanning Process Group consists of those processes that establish the total scope of the effort, define and refine the objectives, and develop the course of action required to attain those objectives. The processes in the Planning Process Group develop the components of the project management plan and the project documents used to carry out the project. The nature of a project may require the use of repeated feedback loops for additional analysis. As more project information or characteristics are gathered and understood, additional planning will likely be required. Significant changes that occur throughout the project life cycle may initiate a need to revisit one or more of the planning processes and, possibly, one or both of the Initiating processes. This ongoing refinement of the project management plan is called progressive elaboration, indicating that planning and documentation are iterative or ongoing activities. The key benefit of this Process Group is to define the course of action to successfully complete the project or phase. The project management team seeks input and encourages involvement from relevant stakeholders while planning the project and developing the project management plan and project documents. When the initial planning effort is completed, the approved version of the project management plan is considered a baseline. Throughout the project, the Monitoring and Controlling processes compare the project performance to the baselines. The Planning Process Group (Figure 3-1) includes the project management processes identified in Sections 3.1 to 3.24.
  • 618.
    3.1 DEVELOP PROJECTMANAGEMENT PLAN Develop Project Management Plan is the process of defining, preparing, and coordinating all plan components and consolidating them into an integrated project management plan. The key benefit of this process is the production of a comprehensive document that defines the basis of all project work and how the work will be performed. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-2.
  • 619.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.2 PLAN SCOPE MANAGEMENT Plan Scope Management is the process of creating a scope management plan that documents how the project and product scope will be defined, validated, and controlled. The key benefit of this process is that it provides guidance and direction on how scope will be managed throughout the project. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-3. The needs of the project determine which components of the project management plan are necessary. 3.2.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Quality management plan, Project life cycle description, and
  • 620.
    Development approach. 3.3 COLLECTREQUIREMENTS Collect Requirements is the process of determining, documenting, and managing stakeholder needs and requirements to meet objectives. The key benefit of this process is that it provides the basis for defining the product scope and project scope. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-4. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.3.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Scope management plan, Requirements management plan, and Stakeholder engagement plan. 3.3.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log,
  • 621.
    Lessons learned register,and Stakeholder register. 3.4 DEFINE SCOPE Define Scope is the process of developing a detailed description of the project and product. The key benefit of this process is that it describes the product, service, or result boundaries and acceptance criteria. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-5. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.4.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the scope management plan. 3.4.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Requirements documentation, and Risk register.
  • 622.
    3.4.3 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Requirements documentation, Requirements traceability matrix, and Stakeholder register. 3.5 CREATE WBS Create Work Breakdown Structure (WBS) is the process of subdividing project deliverables and project work into smaller, more manageable components. The key benefit of this process is that it provides a framework of what has to be delivered. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-6. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.5.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the scope management plan. 3.5.2 PROJECT DOCUMENTS EXAMPLES
  • 623.
    Examples of projectdocuments that may be inputs for this process include but are not limited to: Project scope statement, and Requirements documentation. 3.5.3 PROJECT DOCUMENTS UPDATES Project document that may be updated as a result of this process include but is not limited to: Assumption log, and Requirements documentation. 3.6 PLAN SCHEDULE MANAGEMENT Plan Schedule Management is the process of establishing the policies, procedures, and documentation for planning, developing, managing, executing, and controlling the project schedule. The key benefit of this process is that it provides guidance and direction on how the project schedule will be managed throughout the project. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-7. The needs of the project determine which components of the project management plan are necessary. 3.6.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to:
  • 624.
    Scope management plan,and Development approach. 3.7 DEFINE ACTIVITIES Define Activities is the process of identifying and documenting the specific actions to be performed to produce the project deliverables. The key benefit of this process is that it decomposes work packages into schedule activities that provide a basis for estimating, scheduling, executing, monitoring, and controlling the project work. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-8. The needs of the project determine which components of the project management plan are necessary. 3.7.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, and Scope baseline. 3.7.2 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Schedule baseline, and
  • 625.
    Cost baseline. 3.8 SEQUENCEACTIVITIES Sequence Activities is the process of identifying and documenting relationships among the project activities. The key benefit of this process is that it defines the logical sequence of work to obtain the greatest efficiency given all project constraints. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-9. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.8.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, and Scope baseline. 3.8.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Activity attributes, Activity list, Assumption log, and
  • 626.
    Milestone list. 3.8.3 PROJECTDOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Activity attributes, Activity list, Assumption log, and Milestone list. 3.9 ESTIMATE ACTIVITY DURATIONS Estimate Activity Durations is the process of estimating the number of work periods needed to complete individual activities with estimated resources. The key benefit of this process is that it provides the amount of time each activity will take to complete. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-10. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.9.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, and
  • 627.
    Scope baseline. 3.9.2 PROJECTDOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Activity attributes, Activity list, Assumption log, Lessons learned register, Milestone list, Project team assignments, Resource breakdown structure, Resource calendars, Resource requirements, and Risk register. 3.9.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Activity attributes, Assumption log, Lessons learned register. 3.10 DEVELOP SCHEDULE Develop Schedule is the process of analyzing activity sequences, durations, resource requirements, and schedule constraints to create a schedule model for project execution and monitoring and controlling. The key benefit of this process is that it generates a schedule model with planned dates for completing project activities. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-11.
  • 628.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.10.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, and Scope baseline. 3.10.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Activity attributes, Activity list, Assumption log, Basis of estimates, Duration estimates, Lessons learned register, Milestone list, Project schedule network diagram, Project team assignments,
  • 629.
    Resource calendars, Resource requirements,and Risk register. 3.10.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Schedule management plan, and Cost baseline. 3.10.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Activity attributes, Assumption log, Duration estimates, Lessons learned register, Resource requirements, and Risk register. 3.11 PLAN COST MANAGEMENT Plan Cost Management is the process of defining how the project costs will be estimated, budgeted, managed, monitored, and controlled. The key benefit of this process is that it provides guidance and direction on how the project costs will be managed throughout the project. This process is performed once, or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-12.
  • 630.
    The needs ofthe project determine which components of the project management plan are necessary. 3.11.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, and Risk management plan. 3.12 ESTIMATE COSTS Estimate Costs is the process of developing an approximation of the monetary resources needed to complete project work. The key benefit of this process is that it determines the monetary resources required for the project. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 3-13. The needs of the project determine which components of the project management plan and which project documents are necessary.
  • 631.
    3.12.1 PROJECT MANAGEMENTPLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Cost management plan, Quality management plan, and Scope baseline. 3.12.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Project schedule, Resource requirements, and Risk register. 3.12.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Lessons learned register, and Risk register. 3.13 DETERMINE BUDGET Determine Budget is the process of aggregating the estimated costs of individual activities or work packages to establish an authorized cost baseline. The key benefit of this process is that it determines the cost baseline against which project performance can be monitored and controlled. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-14.
  • 632.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.13.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Cost management plan, Resource management plan, and Scope baseline. 3.13.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Basis of estimates, Cost estimates, Project schedule, and Risk register. 3.13.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Cost estimates,
  • 633.
    Project schedule, and Riskregister. 3.14 PLAN QUALITY MANAGEMENT Plan Quality Management is the process of identifying quality requirements and/or standards for the project and its deliverables, and documenting how the project will demonstrate compliance with quality requirements and/or standards. The key benefit of this process is that it provides guidance and direction on how quality will be managed and verified throughout the project. This process is performed once or at predefined points in the project. The inputs and outputs of this process are shown in Figure 3-15. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.14.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Requirements management plan, Risk management plan, Stakeholder engagement plan, and Scope baseline. 3.14.2 PROJECT DOCUMENTS EXAMPLES
  • 634.
    Examples of projectdocuments that may be inputs for this process include but are not limited to: Assumption log, Requirements documentation, Requirements traceability matrix, Risk register, and Stakeholder register. 3.14.3 PROJECT MANAGEMENT PLAN UPDATES Examples of project management plan components that may be updated as a result of this process include but are not limited to: Risk management plan, and Scope baseline. 3.14.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Requirements traceability matrix, Risk register, and Stakeholder register. 3.15 PLAN RESOURCE MANAGEMENT Plan Resource Management is the process of defining how to estimate, acquire, manage, and utilize physical and team resources. The key benefit of this process is that it establishes the approach and level of management effort needed for managing project resources based on the type and complexity of the project. This process is performed once or at predefined points in the project. The inputs and outputs of this process are shown in Figure 3-16.
  • 635.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.15.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Quality management plan, and Scope baseline. 3.15.2 PROJECT DOCUMENTS Examples of project documents that may be inputs for this process include but are not limited to: Project schedule, Requirements documentation, Risk register, and Stakeholder register. 3.15.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, and Risk register.
  • 636.
    3.16 ESTIMATE ACTIVITYRESOURCES Estimate Activity Resources is the process of estimating team resources and the type and quantities of materials, equipment, and supplies necessary to perform project work. The key benefit of this process is that it identifies the type, quantity, and characteristics of resources required to complete the project. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 3-17. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.16.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, and Scope baseline. 3.16.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Activity attributes, Activity list, Assumption log, Cost estimates, Resource calendars, and
  • 637.
    Risk register. 3.16.3 PROJECTDOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Activity attributes, Assumption log, Lessons learned register. 3.17 PLAN COMMUNICATIONS MANAGEMENT Plan Communications Management is the process of developing an appropriate approach and plan for project communication activities based on the information needs of each stakeholder or group, available organizational assets, and the needs of the project. The key benefit of this process is a documented approach to effectively and efficiently engage stakeholders by presenting relevant information in a timely manner. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 3-18. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.17.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to:
  • 638.
    Resource management plan,and Stakeholder engagement plan. 3.17.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Requirements documentation, and Stakeholder register. 3.17.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to the stakeholder engagement plan. 3.17.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Project schedule, and Stakeholder register. 3.18 PLAN RISK MANAGEMENT Plan Risk Management is the process of defining how to conduct risk management activities for a project. The key benefit of this process is that it ensures that the degree, type, and visibility of risk management are proportionate to both the risks and the importance of the project to the organization and other stakeholders. This process is performed once or at predefined points in the project. The inputs and output of this process are depicted in Figure 3-19.
  • 639.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.18.1 PROJECT MANAGEMENT PLAN COMPONENTS In planning Project Risk Management, all available components of the project management plan should be taken into consideration in order to ensure risk management is consistent with the needs of the project. 3.18.2 PROJECT DOCUMENTS EXAMPLES An example of a project document that may be an input for this process includes but is not limited to the stakeholder register. 3.19 IDENTIFY RISKS Identify Risks is the process of identifying individual project risks as well as sources of overall project risk, and documenting their characteristics. The key benefit of this process is the documentation of the existing individual project risks and the sources of overall project risk. It also brings together information so the project team can to respond appropriately to the identified risks. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-20.
  • 640.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.19.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Requirements management plan, Schedule management plan, Cost management plan, Quality management plan, Resource management plan, Risk management plan, Scope baseline, Schedule baseline, and Cost baseline. 3.19.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Cost estimates, Duration estimates,
  • 641.
    Issue log, Lessons learnedregister, Requirements documentation, Resource requirements, and Stakeholder register. 3.19.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Issue log, and Lessons learned register. 3.20 PERFORM QUALITATIVE RISK ANALYSIS Perform Qualitative Risk Analysis is the process of prioritizing individual project risks for further analysis or action by assessing their probability of occurrence and impact as well as other characteristics. The key benefit of this process is that it focuses efforts on high-priority risks. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-21. The needs of the project determine which components of the project management plan and which project documents are necessary.
  • 642.
    3.20.1 PROJECT MANAGEMENTPLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the risk management plan. 3.20.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Risk register, and Stakeholder register. 3.20.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Issue log, Risk register, and Risk report. 3.21 PERFORM QUANTITATIVE RISK ANALYSIS Perform Quantitative Risk Analysis is the process of numerically analyzing the combined effect of identified individual project risks and other sources of uncertainty on overall project objectives. The key benefit of this process is that it quantifies overall project risk exposure and can also provide additional quantitative risk information to support risk response planning. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-22.
  • 643.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 3.21.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Risk management plan, Scope baseline, Schedule baseline, and Cost baseline. 3.21.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Basis of estimates, Cost estimates, Cost forecasts, Duration estimates, Milestone list, Resource requirements, Risk register, Risk report, and
  • 644.
    Schedule forecasts. 3.21.3 PROJECTDOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to the risk report. 3.22 PLAN RISK RESPONSES Plan Risk Responses is the process of developing options, selecting strategies, and agreeing on actions to address overall project risk exposure as well as to treat individual project risks. The key benefit of this process is that it identifies appropriate ways to address overall project risk and individual project risks. This process also allocates resources and inserts activities into project documents and the project management plan as needed. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 3-23. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.22.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Risk management plan, and Cost baseline.
  • 645.
    3.22.2 PROJECT DOCUMENTSEXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Project schedule, Project team assignments, Resource calendars, Risk register, Risk report, and Stakeholder register. 3.22.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Schedule management plan, Cost management plan, Quality management plan, Resource management plan, Procurement management plan, Scope baseline, Schedule baseline, and Cost baseline. 3.22.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Cost forecasts, Lessons learned register,
  • 646.
    Project schedule, Project teamassignments, Risk register, and Risk report. 3.23 PLAN PROCUREMENT MANAGEMENT Plan Procurement Management is the process of documenting project procurement decisions, specifying the approach, and identifying potential sellers. The key benefit of this process is that it determines whether to acquire goods and services from outside the project and, if so, what to acquire as well as how and when to acquire it. Goods and services may be procured from other parts of the performing organization or from external sources. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 3-24. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.23.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to:
  • 647.
    Scope management plan, Qualitymanagement plan, Resource management plan, and Scope baseline. 3.23.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Milestone list, Project team assignments, Requirements documentation, Requirements traceability matrix, Resource requirements, Risk register, and Stakeholder register. 3.23.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Milestone list, Requirements documentation, Requirements traceability matrix, Risk register, and Stakeholder register. 3.24 PLAN STAKEHOLDER ENGAGEMENT Plan Stakeholder Engagement is the process of developing approaches to involve project stakeholders based on their needs, expectations, interests, and
  • 648.
    potential impact onthe project. The key benefit is that it provides an actionable plan to interact with stakeholders effectively. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 3-25. The needs of the project determine which components of the project management plan and which project documents are necessary. 3.24.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Communications management plan, and Risk management plan. 3.24.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Change log, Issue log, Project schedule, Risk register, and Stakeholder register.
  • 649.
    4 EXECUTING PROCESS GROUP TheExecuting Process Group consists of those processes performed to complete the work defined in the project management plan to satisfy the project requirements. This Process Group involves coordinating resources, managing stakeholder engagement, and integrating and performing the activities of the project in accordance with the project management plan. The key benefit of this Process Group is that the work needed to meet the project requirements and objectives is performed according to plan. A large portion of the project budget, resources, and time is expended in performing the Executing Process Group processes. The processes in the Executing Process Group may generate change requests. If approved, the change requests may trigger one or more planning processes that result in a modified management plan, project documents, and possibly new baselines. The Executing Process Group (Figure 4-1) includes the project management processes identified in Sections 4.1 through 4.10.
  • 650.
    4.1 DIRECT ANDMANAGE PROJECT WORK Direct and Manage Project Work is the process of leading and performing the work defined in the project management plan and implementing approved changes to achieve the project's objectives. The key benefit of this process is that it provides overall management of the project work and deliverables, thus improving the probability of project success. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 4-2.
  • 651.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 4.1.1 PROJECT MANAGEMENT PLAN COMPONENTS Any component of the project management plan may be an input for this process. 4.1.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Change log, Lessons learned register, Milestone list, Project communications, Project schedule, Requirements traceability matrix, Risk register, and Risk report. 4.1.3 PROJECT MANAGEMENT PLAN UPDATES
  • 652.
    Any component ofthe project management plan may be updated as a result of this process. 4.1.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Activity list, Assumption log, Lessons learned register, Requirements documentation, Risk register, and Stakeholder register. 4.2 MANAGE PROJECT KNOWLEDGE Manage Project Knowledge is the process of using existing knowledge and creating new knowledge to achieve the project's objectives and contribute to organizational learning. The key benefits of this process are that prior organizational knowledge is leveraged to produce or improve the project outcomes and that knowledge created by the project is available to support organizational operations and future projects or phases. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 4-3. The needs of the project determine which components of the project
  • 653.
    management plan andwhich project documents are necessary. 4.2.1 PROJECT MANAGEMENT PLAN COMPONENTS All components of the project management plan may be inputs for this process. 4.2.2 PROJECT DOCUMENTS Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Project team assignments, Resource breakdown structure, Source selection criteria, and Stakeholder register. 4.2.3 PROJECT MANAGEMENT PLAN UPDATES Any component of the project management plan may be updated as a result of this process. 4.3 MANAGE QUALITY Manage Quality is the process of translating the quality management plan into executable quality activities that incorporate the organization's quality policies into the project. The key benefit of this process is that it increases the probability of meeting the quality objectives, as well as identifying ineffective processes and causes of poor quality. This process is performed throughout the project. The inputs and outputs of this process are shown in Figure 4-4.
  • 654.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 4.3.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the quality management plan. 4.3.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Quality control measurements, Quality metrics, and Risk report. 4.3.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Quality management plan, Scope baseline, Schedule baseline,
  • 655.
    Cost baseline. 4.3.4 PROJECTDOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Issue log, Lessons learned register, and Risk register. 4.4 ACQUIRE RESOURCES Acquire Resources is the process of obtaining team members, facilities, equipment, materials, supplies, and other resources necessary to complete project work. The key benefit of this process is that it outlines and guides the selection of resources and assigns them to their respective activities. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are shown in Figure 4-5. The needs of the project determine which components of the project management plan and which project documents are necessary.
  • 656.
    4.4.1 PROJECT MANAGEMENTPLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Procurement management plan, and Cost baseline. 4.4.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Project schedule Resource calendars, Resource requirements, and Stakeholder register. 4.4.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Resource management plan, and Cost baseline. 4.4.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Project schedule, Resource breakdown structure, Resource calendars, Resource requirements,
  • 657.
    Risk register, and Stakeholderregister. 4.5 DEVELOP TEAM Develop Team is the process of improving competencies, team member interaction, and overall team environment to enhance project performance. The key benefit of this process is that it results in improved teamwork, enhanced interpersonal skills and competencies, motivated employees, reduced attrition, and improved overall project performance. This process is performed throughout the project. The inputs and outputs of this process are shown in Figure 4-6. The needs of the project determine which components of the project management plan and which project documents are necessary. 4.5.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the resource management plan. 4.5.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to:
  • 658.
    Lessons learned register, Projectschedule, Project team assignments, Resource calendars, and Team charter. 4.5.3 PROJECT MANAGEMENT PLAN UPDATES A component of the project management plan that may be updated as a result of this process includes but is not limited to the resource management plan. 4.5.4 PROJECT DOCUMENTS UPDATES A project document that may be updated as a result of this process includes but is not limited to: Lessons learned register, Project schedule, Project team assignments, Resource calendars, and Team charter. 4.6 MANAGE TEAM Manage Team is the process of tracking team member performance, providing feedback, resolving issues, and managing team changes to optimize project performance. The key benefit of this process is that it influences team behavior, manages conflict, and resolves issues. This process is performed throughout the project. The inputs and outputs of this process are shown in Figure 4-7.
  • 659.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 4.6.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the resource management plan. 4.6.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Issue log, Lessons learned register, Project team assignments, and Team charter. 4.6.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Resource management plan, Schedule baseline, and Cost baseline.
  • 660.
    4.6.4 PROJECT DOCUMENTSUPDATES Project documents that may be updated as a result of this process include but are not limited to: Issue log, Lessons learned register, and Project team assignments. 4.7 MANAGE COMMUNICATIONS Manage Communications is the process of ensuring timely and appropriate collection, creation, distribution, storage, retrieval, management, monitoring, and the ultimate disposition of project information. The key benefit of this process is that it enables an efficient and effective information flow between the project team and the stakeholders. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 4-8. The needs of the project determine which components of the project management plan and which project documents are necessary. 4.7.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Communications management plan, and
  • 661.
    Stakeholder engagement plan. 4.7.2PROJECT DOCUMENTS EXAMPLE Examples of project documents that may be inputs for this process include but are not limited to: Change log, Issue log, Lessons learned register, Quality report, Risk report, and Stakeholder register. 4.7.3 PROJECT MANAGEMENT PLAN UPDATES Examples of the project management plan components that may be updated as a result of this process include but are not limited to: Communications management plan, and Stakeholder engagement plan. 4.7.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Issue log, Lessons learned register, Project schedule, Risk register, and Stakeholder register. 4.8 IMPLEMENT RISK RESPONSES
  • 662.
    Implement Risk Responsesis the process of implementing agreed-upon risk response plans. The key benefit of this process is that it ensures that agreed-upon risk responses are executed as planned in order to address overall project risk exposure, as well as to minimize individual project threats and maximize individual project opportunities. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 4-9. The needs of the project determine which components of the project management plan and which project documents are necessary. 4.8.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the risk management plan. 4.8.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Risk register, and Risk report. 4.8.3 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to:
  • 663.
    Issue log, Lessons learnedregister, Project team assignments, Risk register, and Risk report. 4.9 CONDUCT PROCUREMENTS Conduct Procurements is the process of obtaining seller responses, selecting a seller, and awarding a contract. The key benefit of this process is that it selects a qualified seller and implements the legal agreement for delivery. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 4-10. The needs of the project determine which components of the project management plan and which project documents are necessary. 4.9.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Scope management plan, Requirements management plan, Communications management plan,
  • 664.
    Risk management plan, Procurementmanagement plan, Configuration management plan, and Cost baseline. 4.9.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Project schedule, Requirements documentation, Risk register, and Stakeholder register. 4.9.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Requirements management plan, Quality management plan, Communications management plan, Risk management plan, Procurement management plan, Scope baseline, Schedule baseline, and Cost baseline. 4.9.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to:
  • 665.
    Lessons learned register, Requirementsdocumentation, Requirements traceability matrix, Resource calendars, Risk register, and Stakeholder register. 4.10 MANAGE STAKEHOLDER ENGAGEMENT Manage Stakeholder Engagement is the process of communicating and working with stakeholders to meet their needs and expectations, address issues, and foster appropriate stakeholder involvement. The key benefit of this process is that it allows the project manager to increase support and minimize resistance from stakeholders. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 4-11. The needs of the project determine which components of the project management plan and which project documents are necessary. 4.10.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Communications management plan, Risk management plan, Stakeholder engagement plan, and
  • 666.
    Change management plan. 4.10.2PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Change log, Issue log, Lessons learned register, and Stakeholder register. 4.10.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Communications management plan, and Stakeholder engagement plan. 4.10.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Change log, Issue log, Lessons learned register, and Stakeholder register.
  • 667.
    5 MONITORING AND CONTROLLINGPROCESS GROUP The Monitoring and Controlling Process Group consists of those processes required to track, review, and regulate the progress and performance of the project; identify any areas in which changes to the plan are required; and initiate the corresponding changes. Monitoring is collecting project performance data, producing performance measures, and reporting and disseminating performance information. Controlling is comparing actual performance with planned performance, analyzing variances, assessing trends to effect process improvements, evaluating possible alternatives, and recommending appropriate corrective action as needed. The key benefit of this Process Group is that project performance is measured and analyzed at regular intervals, appropriate events, or when exception conditions occur in order to identify and correct variances from the project management plan. The Monitoring and Controlling Process Group also involves: Evaluating change requests and deciding on the appropriate response; Recommending corrective or preventive action in anticipation of possible problems; Monitoring the ongoing project activities against the project management plan and project baselines; and Influencing the factors that could circumvent the change control process so only approved changes are implemented. Continuous monitoring provides the project team and other stakeholders with insight into the status of the project and identifies any areas that require additional attention. The Monitoring and Controlling Process Group monitors and controls the work being done within each Knowledge Area, each Process Group, each life cycle phase, and the project as a whole. The Monitoring and Controlling Process Group (Figure 5-1) includes the project management
  • 668.
    processes identified inSections 5.1 through 5.12. 5.1 MONITOR AND CONTROL PROJECT WORK Monitor and Control Project Work is the process of tracking, reviewing, and reporting the overall progress to meet the performance objectives defined in the project management plan. The key benefit of this process is that it allows stakeholders to understand the current state of the project, to recognize the actions taken to address any performance issues, and to have visibility into the future project status with cost and schedule forecasts. This process is performed throughout the project. The inputs and outputs for this process are depicted in Figure 5-2.
  • 669.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 5.1.1 PROJECT MANAGEMENT PLAN COMPONENTS Any component of the project management plan may be an input for this process. 5.1.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Basis of estimates, Cost forecasts, Issue log, Lessons learned register, Milestone list, Quality reports, Risk register, Risk report, and Schedule forecasts.
  • 670.
    5.1.3 PROJECT MANAGEMENTPLAN UPDATES Any component of the project management plan may be updated as a result of this process. 5.1.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Cost forecasts, Issue log, Lessons learned register, Risk register, and Schedule forecasts. 5.2 PERFORM INTEGRATED CHANGE CONTROL Perform Integrated Change Control is the process of reviewing all change requests; approving changes and managing changes to deliverables, organizational process assets, project documents, and the project management plan; and communicating the decisions. This process reviews all requests for changes to project documents, deliverables, or the project management plan, and determines the resolution of the change requests. The key benefit of this process is that it allows for documented changes within the project to be considered in an integrated manner while addressing overall project risk, which often arises from changes made without consideration of the overall project objectives or plans. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-3.
  • 671.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 5.2.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Change management plan, Configuration management plan, Scope baseline, Schedule baseline, and Cost baseline. 5.2.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Basis of estimates, Requirements traceability matrix, and Risk report. 5.2.3 PROJECT MANAGEMENT PLAN UPDATES Any component of the project management plan may be updated as a result of
  • 672.
    this process. 5.2.4 PROJECTDOCUMENTS UPDATES Any formally controlled project document may be changed as a result of this process. A project document that is normally updated as a result of this process is the change log. The change log is used to document changes that occur during a project. 5.3 VALIDATE SCOPE Validate Scope is the process of formalizing acceptance of the completed project deliverables. The key benefit of this process is that it brings objectivity to the acceptance process and increases the probability of final product, service, or result acceptance by validating each deliverable. This process is performed periodically throughout the project as needed. The inputs and outputs of this process are depicted in Figure 5-4. The needs of the project determine which components of the project management plan and which project documents are necessary. 5.3.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Scope management plan, Requirements management plan, and
  • 673.
    Scope baseline. 5.3.2 PROJECTDOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Quality reports, Requirements documentation, and Requirements traceability matrix. 5.3.3 PROJECT DOCUMENTS UPDATES Examples of project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Requirements documentation, and Requirements traceability matrix. 5.4 CONTROL SCOPE Control Scope is the process of monitoring the status of the project and product scope and managing changes to the scope baseline. The key benefit of this process is that the scope baseline is maintained throughout the project. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-5.
  • 674.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 5.4.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Scope management plan, Requirements management plan, Change management plan, Configuration management plan, Scope baseline, and Performance measurement baseline. 5.4.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Requirements documentation, and Requirements traceability matrix. 5.4.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result
  • 675.
    of this processinclude but are not limited to: Scope management plan, Scope baseline, Schedule baseline, Cost baseline and Performance measurement baseline. 5.4.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Requirements documentation, and Requirements traceability matrix. 5.5 CONTROL SCHEDULE Control Schedule is the process of monitoring the status of the project to update the project schedule and manage changes to the schedule baseline. The key benefit of this process is that the schedule baseline is maintained throughout the project. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-6. The needs of the project determine which components of the project management plan and which project documents are necessary.
  • 676.
    5.5.1 PROJECT MANAGEMENTPLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Schedule management plan, Schedule baseline, Scope baseline, and Performance measurement baseline. 5.5.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Project calendars, Project schedule, Resource calendars, and Schedule data. 5.5.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Schedule management plan, Schedule baseline, and Cost baseline and Performance measurement baseline. 5.5.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log,
  • 677.
    Basis of estimates, Lessonslearned register, Project schedule, Resource calendars, Risk register, and Schedule data. 5.6 CONTROL COSTS Control Costs is the process of monitoring the status of the project to update the project costs and managing changes to the cost baseline. The key benefit of this process is that the cost baseline is maintained throughout the project. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-7. The needs of the project determine which components of the project management plan are necessary. 5.6.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Cost management plan, Cost baseline, and Performance measurement baseline.
  • 678.
    5.6.2 PROJECT DOCUMENTSEXAMPLES An example of a project document that may an input for this process includes but is not limited to the lessons learned register. 5.6.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Cost management plan, Cost baseline, and Performance measurement baseline. 5.6.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Basis of estimates, Cost estimates, Lessons learned register, and Risk register. 5.7 CONTROL QUALITY Control Quality is the process of monitoring and recording results of executing the quality management activities to assess performance and ensure the project outputs are complete, correct, and meet customer expectations. The key benefit of this process is verifying that project deliverables and work meet the requirements specified by key stakeholders for final acceptance. This process is performed throughout the project. The inputs and outputs of this process are shown in Figure 5-8.
  • 679.
    The needs ofthe project determine which components of the project management plan and which project documents are necessary. 5.7.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the quality management plan. 5.7.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Lessons learned register, Quality metrics, and Test and evaluation documents. 5.7.3 PROJECT MANAGEMENT PLAN UPDATES A component of the project management plan that may be updated as a result of this process includes but is not limited to the quality management plan. 5.7.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to:
  • 680.
    Issue log, Lessons learnedregister, Risk register, and Test and evaluation documents. 5.8 CONTROL RESOURCES Control Resources is the process of ensuring that the physical resources assigned and allocated to the project are available as planned, as well as monitoring the planned versus actual utilization of resources and taking corrective action as necessary. The key benefit of this process is ensuring that the assigned resources are available to the project at the right time and in the right place and are released when no longer needed. This process is performed throughout the project. The inputs and outputs of this process are shown in Figure 5-9. The needs of the project determine which components of the project management plan and which project documents are necessary. 5.8.1 PROJECT MANAGEMENT PLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the resource management plan. 5.8.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but
  • 681.
    are not limitedto: Issue log, Lessons learned register, Physical resource assignments, Project schedule Resource breakdown structure, Resource requirements, and Risk register. 5.8.3 PROJECT MANAGEMENT PLAN UPDATES A component of the project management plan that may be updated as a result of this process includes but is not limited to: Resource management plan, Schedule baseline, and Cost baseline. 5.8.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Issue log, Lessons learned register, Physical resource assignments, Resource breakdown structure, and Risk register. 5.9 MONITOR COMMUNICATIONS Monitor Communications is the process of ensuring the information needs of the project and its stakeholders are met. The key benefit of this process is the
  • 682.
    optimal information flowas defined in the communications management plan and stakeholder engagement plan. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-10. The needs of the project determine which components of the project management plan and which project documents are necessary. 5.9.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Communications management plan, and Stakeholder engagement plan. 5.9.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Issue log, Lessons learned register, and Project communications. 5.9.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result
  • 683.
    of this processinclude but are not limited to: Communications management plan, and Stakeholder engagement plan. 5.9.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Issue log, Lessons learned register, and Stakeholder register. 5.10 MONITOR RISKS Monitor Risks is the process of monitoring the implementation of agreed-upon risk response plans, tracking identified risks, identifying and analyzing new risks, and evaluating risk process effectiveness throughout the project. The key benefit of this process is that it enables project decisions to be based on current information about overall project risk exposure and individual project risks. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-11. The needs of the project determine which components of the project management plan and which project documents are necessary.
  • 684.
    5.10.1 PROJECT MANAGEMENTPLAN COMPONENTS An example of a project management plan component that may be an input for this process includes but is not limited to the risk management plan. 5.10.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Issue log, Lessons learned register, Risk register, and Risk report. 5.10.3 PROJECT MANAGEMENT PLAN UPDATES Any component of the project management plan may be updated as a result of this process. 5.10.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Assumption log, Issue log, Lessons learned register, Risk register, and Risk report. 5.11 CONTROL PROCUREMENTS Control Procurements is the process of managing procurement relationships, monitoring contract performance and making changes and corrections as appropriate, and closing out contracts. The key benefit of this process is that it
  • 685.
    ensures that boththe seller's and buyer's performance meets the project's requirements according to the terms of the legal agreements. This process is performed throughout the project, when procurements are active. The inputs and outputs of this process are depicted in Figure 5-12. The needs of the project determine which components of the project management plan and which project documents are necessary. 5.11.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Requirements management plan, Risk management plan, Procurement management plan, Change management plan, and Schedule baseline. 5.11.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log,
  • 686.
    Lessons learned register, Milestonelist, Quality reports, Requirements documentation, Requirements traceability matrix, Risk register, and Stakeholder register. 5.11.3 PROJECT MANAGEMENT PLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Risk management plan, Procurement management plan, Schedule baseline, and Cost baseline. 5.11.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Lessons learned register, Resource requirements, Requirements traceability matrix, Risk register, and Stakeholder register. 5.12 MONITOR STAKEHOLDER ENGAGEMENT Monitor Stakeholder Engagement is the process of monitoring project stakeholder relationships, and tailoring strategies for engaging stakeholders through modification of engagement strategies and plans. The key benefit of this
  • 687.
    process is thatit maintains or increases the efficiency and effectiveness of stakeholder engagement activities as the project evolves and its environment changes. This process is performed throughout the project. The inputs and outputs of this process are depicted in Figure 5-13. The needs of the project determine which components of the project management plan and which project documents are necessary. 5.12.1 PROJECT MANAGEMENT PLAN COMPONENTS Examples of project management plan components that may be inputs for this process include but are not limited to: Resource management plan, Communications management plan, and Stakeholder engagement plan. 5.12.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Issue log, Lessons learned register, Project communications, Risk register, and Stakeholder register.
  • 688.
    5.12.3 PROJECT MANAGEMENTPLAN UPDATES Components of the project management plan that may be updated as a result of this process include but are not limited to: Resource management plan, Communications management plan, and Stakeholder engagement plan. 5.12.4 PROJECT DOCUMENTS UPDATES Project documents that may be updated as a result of this process include but are not limited to: Issue log, Lessons learned register, Risk register, and Stakeholder register.
  • 689.
    6 CLOSING PROCESS GROUP TheClosing Process Group consists of the process(es) performed to formally complete or close a project, phase, or contract. This Process Group verifies that the defined processes are completed within all of the Process Groups to close the project or phase, as appropriate, and formally establishes that the project or project phase is complete. The key benefit of this Process Group is that phases, projects, and contracts are closed out appropriately. While there is only one process in this Process Group, organizations may have their own processes associated with project, phase, or contract closure. Therefore, the term Process Group is maintained. This Process Group may also address the early closure of the project, for example, aborted projects or cancelled projects. The Closing Process Group (Figure 6-1) includes the project management process identified in Section 6.1.
  • 690.
    6.1 CLOSE PROJECTOR PHASE Close Project or Phase is the process of finalizing all activities for the project, phase, or contract. The key benefits of this process are the project or phase information is archived, the planned work is completed, and organizational resources are released to pursue new endeavors. This process is performed once or at predefined points in the project. The inputs and outputs of this process are depicted in Figure 6-2. The needs of the project determine which components of the project management plan and which project documents are necessary. 6.1.1 PROJECT MANAGEMENT PLAN COMPONENTS All components of the project management plan may be inputs to this process. 6.1.2 PROJECT DOCUMENTS EXAMPLES Examples of project documents that may be inputs for this process include but are not limited to: Assumption log, Basis of estimates, Change log, Issue log, Lessons learned register,
  • 691.
    Milestone list, Project communications, Qualitycontrol measurements, Quality reports, Requirements documentation, Risk register, and Risk report. 6.1.3 PROJECT DOCUMENTS UPDATES Any project documents that may be updated as a result of this process include but are not limited to the lessons learned register.
  • 692.
    Part 3 Appendices, Glossary,and Index The information contained in this part is not an American National Standard (ANS) and has not been processed in accordance with ANSI's requirements for an ANS. As such, the information in this part may contain material that has not been subjected to public review or a consensus process. In addition, it does not contain requirements necessary for conformance to an ANS standard.
  • 693.
    APPENDIX X1 SIXTH EDITIONCHANGES The purpose of this appendix is to provide an overview of the changes made to A Guide to the Project Management Body of Knowledge (PMBOK® Guide) —Fifth Edition to create the PMBOK® Guide—Sixth Edition. X1.1 SCOPE OF UPDATE The approved scope for the PMBOK® Guide—Sixth Edition includes: Review the following and determine whether the material will be included or excluded in the new editions, and track the disposition: All material relevant to Sections 1 through 13, Annex A1, and the Glossary that was deferred during the development of A Guide to the Project Management Body of Knowledge (PMBOK® Guide)—Fifth Edition All comments and feedback relevant to Sections 1 through 13, Annex A1, and the Glossary of A Guide to the Project Management Body of Knowledge (PMBOK® Guide)—Fifth Edition that have been received by PMI since the initial development and publication. Review, interpret, and ensure appropriate alignment with ISO 21500 in the development of the standard. Ensure harmonization with any other relevant PMI foundational standards. Consider the project manager role delineation study results and other PMI research studies for incorporation as appropriate. Review, conduct, and analyze research for significant additions, deletions, and changes to the Sixth Edition and possibly for strategic input to future editions. With that directive in mind, the update team focused on bringing greater consistency and clarity by refining and standardizing the processes, inputs, tools
  • 694.
    and techniques, andoutputs. X1.2 RULES FOR HARMONIZATION BETWEEN GLOSSARY TERMS AND THE PMI LEXICON OF PROJECT MANAGEMENT TERMS To ensure that terms used in the PMBOK® Guide align with the PMI Lexicon of Project Management Terms 1 and harmonize with other relevant PMI standards, the Sixth Edition followed these business rules: For terms found in both the PMBOK® Guide and the PMI Lexicon, the definition from the PMI Lexicon is used. Where terms used in the PMBOK® Guide are not found in the PMI Lexicon but are found in other relevant PMI standards, the definitions of the terms should be identical. If the definitions do not align with the respective standards, the term is elevated to the PMI Lexicon team for assistance in creating an acceptable common definition. X1.3 RULES FOR HANDLING INPUTS AND OUTPUTS The following business rules were used to provide consistency in the order and information within the inputs and outputs for each project management process: Fundamental Rules: Inputs are any documents that are key to the process. Outputs should become an input to another project management process unless the output is a terminal output or embedded within another input such as project documents. Inputs should come from an output from another project management process unless the input comes from outside the project. Project Documents Rules: When specific project documents are identified the first time, they are listed as a specific output. Subsequently, they are listed as “project documents updates” in the output list, and described in the section
  • 695.
    narrative. When any projectdocument is an input, the term “project documents” is listed and the specific project documents are described in the section narrative. Project Management Plan Rules: For those planning processes that create a subsidiary plan, the project charter is the first input and the project management plan is the second input. The process that creates a component of the project management plan lists the component specifically. Subsequently, components are listed as “project management plan updates” in the output list, and described in the section narrative. When the project management plan serves as a process input, specific components of the project management plan that may be considered are described in the section narrative. Sequencing Rules: If the project charter is an input, it is the first input. When the project management plan is an input or output, the subsidiary management plans are listed in the order of the sections in the PMBOK® Guide where they are produced as an output, followed by baselines and then any other plans. Project documents are listed in alphabetical order. Enterprise environmental factors and organizational process assets are listed last in that order. When updates are an output they are listed in the following sequence: Project management plan updates, Project documents updates, and Organizational process assets updates. X1.4 RULES FOR HANDLING TOOLS AND TECHNIQUES The Sixth Edition endeavored to reduce the number of tools and techniques by
  • 696.
    focusing on thosethat are currently used on most projects most of the time. Based on academic and market research a number of tools and techniques were eliminated. In order to reduce repetition a tool or technique is described the first time it is listed and subsequent processes using that tool or technique refer back to the earlier description. The Sixth Edition grouped some of the commonly used tools and techniques by their intent. Not all tools and techniques fall within a group, but for those tools or techniques that are part of a group, the group is listed and then examples of tools and techniques in that group are described in the narrative. The tools and techniques groups are: Data gathering, Data analysis, Data representation, Decision-making, Communication skills, and Interpersonal and team skills. Appendix X6 identifies all the tools and techniques in the PMBOK® Guide by group, where appropriate, and lists the processes where they are used. X1.5 PROJECT MANAGEMENT PLAN Not every component of the project management plan is created in a separate process. Such components are considered to be created in the Develop Project Management Plan process. They include the change management plan, configuration management plan, performance measurement baseline, project life cycle, development approach, and management reviews. X1.6 SECTION 1—INTRODUCTION The Introduction section was significantly rewritten. Introductory information about projects, programs, and portfolios that aligns with other PMI foundational standards remains. However, there is new information on project and development life cycles, project phases, and phase gates. This information provides a high-level overview on selecting development approaches from predictive, iterative, incremental and adaptive, based on the nature of the project.
  • 697.
    New information onbusiness documents includes the business case and the benefits management plan. X1.7 SECTION 2—THE ENVIRONMENT IN WHICH PROJECTS OPERATE The content of Section 2 was significantly rewritten. Information on organizational process assets and enterprise environmental factors remains. However, there is new content on governance, management elements, and organizational structure types. X1.8 Section 3—THE ROLE OF THE PROJECT MANAGER This is a new section that outlines the project manager's role on the team. It includes information on the project manager's sphere of influence and competencies. PMI's Talent Triangle® is discussed with its emphasis on strategic and business management skills, technical project management skills, and leadership skills. Leadership styles and personality are also discussed as part of this section. The final part of this section focuses on the project manager as an integrator. X1.9 AGILE Since the Fifth Edition of the PMBOK® Guide there has been more adoption of agile and adaptive methodologies in the management of projects. The Sixth Edition has included a subsection called Considerations for Adaptive Environments at the beginning of Sections 4 through 13. Some agile-specific tools and techniques have been introduced into the PMBOK® Guide, such as sprint and iteration planning. Appendix X3 describes the use of agile, adaptive, iterative, and hybrid approaches from the perspective of the Project Management Process Groups. X1.10 KNOWLEDGE AREA FRONT MATERIAL Each of the Knowledge Area sections includes standardized material prior to introducing the first process. The material is presented in the following
  • 698.
    subsections: Key Concepts. Collectskey concepts associated with the specific knowledge area. This information was presented in earlier editions; in this edition it is consolidated and presented for consistency between knowledge areas. These key concepts are compiled in Appendix X4. Trends and Emerging Practices. The profession of project management continues to evolve. However, the purpose of the PMBOK® Guide is not to lead the industry; it is to describe what is considered good practice on most projects most of the time. This subsection identifies some of the trends or emerging practices that are occurring, but that may not be practiced on most projects. Tailoring Considerations. The Sixth Edition emphasizes the importance of tailoring all aspects of the project to meet the needs of the organization, environment, stakeholders and other variables. This subsection identifies areas the project manager can consider when tailoring their project. These tailoring considerations are compiled in Appendix X5. Considerations for Agile/Adaptive Environments. This subsection identifies some of the areas where adaptive approaches may differ from predictive approaches in the particular Knowledge Area. X1.11 KNOWLEDGE AREA AND PROCESS CHANGES Two Knowledge Areas names were changed to more closely reflect the work that is done. Project Time Management was changed to Project Schedule Management to reflect that the project schedule is defined and managed during the project, whereas time is not managed. Both team resources and physical resources are addressed in the Sixth Edition. Thus, the Knowledge Area Project Human Resource Management was changed to Project Resource Management. One process was removed and three new processes were added, to reflect changes in the way projects are managed in practice. One process was moved between Knowledge Areas. These changes are summarized below, and discussed in the relevant Knowledge Area section:
  • 699.
    Manage Project Knowledge(Section 4.4)—Added. Estimate Activity Resources (Section 6.4)—Moved to Project Resource Management. Control Resources (Section 9.6)—Added. Implement Risk Responses (Section 11.6)—Added. Close Procurements (Section 12.4)—Eliminated. Several process names were changed to improve consistency across the processes and to improve clarity. Research indicates that project managers tend to monitor, facilitate, and manage rather than control, particularly in processes that involve interactions with people. Therefore, process names for Control Communications, Control Risks, and Control Stakeholder Engagement were changed to Monitor Communications, Monitor Risks, and Monitor Stakeholder Engagement. The list below summarizes all the process name changes: Perform Quality Assurance (Section 8.2)—Changed to Manage Quality. Plan Human Resource Management (Section 9.1)—Changed to Plan Resource Management. Acquire Project Team (Section 9.2)—Changed to Acquire Resources. Develop Project Team (Section 9.3)—Changed to Develop Team. Manage Project Team (Section 9.4)—Changed to Manage Team. Control Communications (Section 10.3)—Changed to Monitor Communications Control Risks (Section 11.6)—Changed to Monitor Risks. Plan Stakeholder Management (Section 13.2)—Changed to Plan Stakeholder Engagement. Control Stakeholder Engagement (Section 13.4)—Changed to Monitor Stakeholder Engagement. X1.12 SECTION 4—PROJECT INTEGRATION MANAGEMENT CHANGES A new process, Manage Project Knowledge, was added. This is a result of many deferred comments from the Fifth Edition indicating the need to address
  • 700.
    knowledge management inprojects. A key output of this process is the lessons learned register. This register is used throughout many of the processes in the Sixth Edition. This emphasizes the need to learn continually throughout the project rather than waiting until the end to reflect. Business documents are inputs to the Develop Project Charter and Close Project or Phase processes. The introduction of business documents underscores the importance of staying attuned to the business case and benefits management throughout the project. Administrative closure activities for procurements have been absorbed into the Close Project or Phase process. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-1 summarizes the Section 4 processes: Table X1-1. Section 4 Changes Fifth Edition Processes Sixth Edition Processes 4.1 Develop Project Charter 4.1 Develop Project Charter 4.2 Develop Project Management Plan 4.2 Develop Project Management Plan 4.3 Direct and Manage Project Work 4.3 Direct and Manage Project Work 4.4 Monitor and Control Project Work 4.4 Manage Project Knowledge 4.5 Perform Integrated Change Control 4.5 Monitor and Control Project Work 4.6 Close Project or Phase 4.6 Perform Integrated Change Control 4.7 Close Project or Phase X1.13 SECTION 5—PROJECT SCOPE MANAGEMENT CHANGES The Sixth Edition team collaborated with The Standard for Business Analysis to ensure that both foundational standards were aligned, though not duplicative. No changes to process names were necessary. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. X1.14 SECTION 6—PROJECT SCHEDULE MANAGEMENT
  • 701.
    CHANGES Section 6 wasrenamed from Project Time Management to Project Schedule Management. Research indicated support for the name change as project managers do not manage time, they define and manage the project schedule. Due to the shift in focus and renaming of Project Human Resource Management to Project Resource Management, the process Estimate Activity Resources was moved from this Knowledge Area to Project Resource Management. Some agile concepts were incorporated into the Develop Schedule process. Figures and associated text were updated to clarify scheduling concepts addressed in the section. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-2 summarizes the Section 6 processes: Table X1-2. Section 6 Changes Fifth Edition Processes Sixth Edition Processes 6.1 Plan Schedule Management 6.1 Plan Schedule Management 6.2 Define Activities 6.2 Define Activities 6.3 Sequence Activities 6.3 Sequence Activities 6.4 Estimate Activity Resources 6.4 Estimate Activity Durations 6.5 Estimate Activity Durations 6.5 Develop Schedule 6.6 Develop Schedule 6.6 Control Schedule 6.7 Control Schedule X1.15 SECTION 7—PROJECT COST MANAGEMENT CHANGES Changes consistent with information described in Sections X1.1 through X1.11 were implemented. X1.16 SECTION 8—PROJECT QUALITY MANAGEMENT CHANGES Academic and market research was conducted regarding the Perform Quality
  • 702.
    Assurance process. Researchindicated that many of the quality tools and techniques that were identified previously are not widely used in today's projects. The profession focuses more on managing quality through the quality management plan. Thus, the Perform Quality Assurance process shifted focus and the name was changed to Manage Quality. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-3 summarizes the Section 8 processes: Table X1-3. Section 8 Changes Fifth Edition Processes Sixth Edition Processes 8.1 Plan Quality Management 8.1 Plan Quality Management 8.2 Perform Quality Assurance 8.2 Manage Quality 8.3 Control Quality 8.3 Control Quality X1.17 SECTION 9—PROJECT RESOURCE MANAGEMENT CHANGES The Sixth Edition expanded the scope of this section from its previous focus on human resources to include all resources. To distinguish between human resources and other resources, the term team resources is used to refer to human resources and the term physical resources is used to refer to other resources. The Estimate Activity Resources process was transferred into this Knowledge Area from Project Schedule Management, and a new process Control Resources was added. The word “project” was eliminated from Develop Team and Manage Team as it is inferred that the only team the project manager is concerned about developing and managing is the project team. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-4 summarizes the Section 9 processes: Table X1-4. Section 9 Changes Fifth Edition Processes Sixth Edition Processes 9.1 Plan Human Resource Management 9.1 Plan Resource Management 9.2 Acquire Project Team 9.2 Estimate Activity Resources
  • 703.
    9.3 Develop ProjectTeam 9.3 Acquire Resources 9.4 Manage Project Team 9.4 Develop Team 9.5 Manage Team 9.6 Control Resources X1.18 SECTION 10—PROJECT COMMUNICATIONS MANAGEMENT CHANGES A subtle but important distinction was made in this section about project communication. The term “communication” indicates the act of communicating, such as facilitating a meeting, giving information and active listening. The term “communications” indicates the artifacts of communication, such as memos, presentations, and emails. Because it is not possible to control how and when people communicate, the name of the Control Communications process has been changed to Monitor Communications. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-5 summarizes the Section 10 processes: Table X1-5. Section 10 Changes Fifth Edition Processes Sixth Edition Processes 10.1 Plan Communications Management 10.1 Plan Communications Management 10.2 Manage Communications 10.2 Manage Communications 10.3 Control Communications 10.3 Monitor Communications X1.19 SECTION 11—PROJECT RISK MANAGEMENT CHANGES An increased emphasis on overall project risk was integrated throughout the risk management processes. A new process, Implement Risk Responses, was added. This process is part of the Executing Process Group. The new process emphasizes the importance of not just planning risk responses, but implementing them as well. A new risk response “escalate” was introduced to indicate that if risks are identified that are outside the scope of the project objectives, they
  • 704.
    should be passedto the relevant person or part of the organization. Because risks are uncertain future events or conditions, they cannot be controlled; however, they can be monitored. Thus, the process Control Risks was renamed to Monitor Risks. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-6 summarizes the Section 11 processes: Table X1-6. Section 11 Changes Fifth Edition Processes Sixth Edition Processes 11.1 Plan Risk Management 11.1 Plan Risk Management 11.2 Identify Risks 11.2 Identify Risks 11.3 Perform Qualitative Risk Analysis 11.3 Perform Qualitative Risk Analysis 11.4 Perform Quantitative Risk Analysis 11.4 Perform Quantitative Risk Analysis 11.5 Plan Risk Responses 11.5 Plan Risk Responses 11.6 Control Risks 11.6 Implement Risk Responses 11.7 Monitor Risks X1.20 SECTION 12—PROJECT PROCUREMENT MANAGEMENT CHANGES Much of the information in this Knowledge Area was updated to reflect a more global perspective. Many projects are conducted with stakeholders in various countries, or by organizations with offices in multiple countries. Market research shows that very few project managers actually close out procurements. Someone in contracts, procurement or legal departments usually has that authority. Therefore, information from Close Procurements about evaluating all completed deliverables and comparing them to the contract was absorbed into Control Procurements. Information about administrative, communications, and records was moved to Close Project or Phase. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-7 summarizes the Section 12 processes: Table X1-7. Section 12 Changes
  • 705.
    Fifth Edition ProcessesSixth Edition Processes 12.1 Plan Procurement Management 12.1 Plan Procurement Management 12.2 Conduct Procurements 12.2 Conduct Procurements 12.3 Administer Procurements 12.3 Control Procurements 12.4 Close Procurements X1.21 SECTION 13—PROJECT STAKEHOLDER MANAGEMENT CHANGES In keeping with current research and practice, a shift was made to focus on stakeholder engagement rather than stakeholder management. Because project managers rarely, if ever, have the ability to control stakeholders, Control Stakeholder Engagement was renamed to Monitor Stakeholder Engagement. Changes consistent with information described in Sections X1.1 through X1.11 were implemented. Table X1-8 summarizes the Section 13 processes: Table X1-8. Section 13 Changes Fifth Edition Processes Sixth Edition Processes 13.1 Identify Stakeholders 13.1 Identify Stakeholders 13.2 Plan Stakeholder Management 13.2 Plan Stakeholder Engagement 13.3 Manage Stakeholder Engagement 13.3 Manage Stakeholder Engagement 13.4 Control Stakeholder Engagement 13.4 Monitor Stakeholder Engagement X1.22 GLOSSARY The glossary of the PMBOK® Guide—Sixth Edition was updated to clarify meaning and improve the quality and accuracy of any translations. Terms that are not used in the Sixth Edition, or are not used differently from everyday usage, were eliminated. 1 Project Management Institute. 2016. The PMI Lexicon of Project
  • 706.
    Management Terms. Availablefrom http://www.pmi.org/Lexiconterms
  • 707.
    APPENDIX X2 CONTRIBUTORS ANDREVIEWERS OF THE PMBOK® GUIDE—SIXTH EDITION PMI volunteers first attempted to codify the Project Management Body of Knowledge in the Special Report on Ethics, Standards, and Accreditation, published in 1983. Since that time, other volunteers have come forward to update and improve that original document and contribute to this globally recognized standard for project management, PMI's A Guide to the Project Management Body of Knowledge (PMBOK® Guide). This appendix lists, those individuals who have contributed to the development and production of the PMBOK® Guide – Sixth Edition. No list can adequately portray all the contributions of those who have volunteered to develop the PMBOK® Guide – Sixth Edition. The Project Management Institute is grateful to all of these individuals for their support and acknowledges their contributions to the project management profession. X2.1 PMBOK® GUIDE—SIXTH EDITION CORE COMMITTEE The following individuals served as members, were contributors of text or concepts, and served as leaders within the Project Core Committee: Cyndi Snyder Dionisio, MBA, PMP, Chair David A. Hillson, PhD, PMI Fellow, HonFAPM, Vice Chair (Volunteer Engagement Lead & Section 11 Lead) Lynda Bourne, DPM, FACS (Sections 10 & 13 Lead) Larkland A. Brown, PMP, PMI-ACP (Section 6 Lead) Pan C.P. Kao, PhD, PMP, (Sections 7 & 12 Lead) Mercedes Martinez Sanz, PMP (Section 4 Lead) Alejandro Romero-Torres, PhD, PMP, (Document Quality & Management Lead & Section 5 Lead) Guy Schleffer, PfMP, PMP, (Sections 8 & 9 Lead) Michael J. Stratton, PhD, PMP (Section 1, 2, & 3 Lead)†
  • 708.
    Kristin L. Vitello,Standards Project Specialist Gwen Whitman, EMBA, PfMP (Project Communications Lead) X2.2 SIGNIFICANT CONTRIBUTORS In addition to the members of the Project Core Committee, the following individuals provided significant input or concepts: Ernest Baker, PMP, PRINCE2® Practitioner Cheryl Burcham, PMP Guido Caciagli, B., PMP Jimmy I. Char, PMP, SDI Cătălin-Teodor Dogaru, PhD, MBA Andrés Falcón, PMP Anna Maria Felici, PMP Eren Gokce, MBA, PMP Pamela S. Goodhue, MBA, PMP Franco R. Graziano, MPA, PMP Joy Gumz, CPA, PMP Salah M. Haswah, PMP, PgMP Puja Kasariya, PMP Srikanth Krishnamoorthy, PMP, PGDSA Tom Magee, MBA, PMP David A. Maynard, MBA, PMP Bob Mahler, PMP, PMI-RMP Frank R. Parth, MBA, PMP Dattatraya Y. Pathak, PMP, PfMP Judy Payne, PhD, MBA Nagy Attalla Saad, PMP, ITIL Davidov Shai Kavita Sharma, PMP, RMP Jurgen T. Sturany, PMP Dirk Withake, PgMP, PMP X2.3 PMBOK® GUIDE—SIXTH EDITION CONTENT
  • 709.
    COMMITTEE The following individualswere contributors of text or concepts and provided recommendations on drafts of the PMBOK® Guide—Sixth Edition: Vahid Azadmanesh, MBA, PMP Brad Bigelow, PMP, MSP Wayne R. Brantley, MSEd, PMP Marcelo A. Briola PhD, PMP Michael C. Broadway, PMP Mariana Nella Caffarena Bolivar Steven Flannes Sandra Fonseca, PhD, CISA, CRISC Theofanis C. Giotis, PMP, PMI-ACP Piyush Govil, BE, PMP Rex M. Holmlin, PE, PMP Éamonn V. Kelly, DBA, PMP Srikanth Krishnamoorthy Fabiano de Alcântara de Lima, PhD, PMP Shashank Neppalli Andrea Pantano Kristine Persun, PMP Piyush Prakash PMP, Prince 2 Raju N. Rao, PMP, SCPM Krupakar Reddy, PMP, PRINCE2 Practitioner Emadeldin Seddik, PhD, PMP Tejas V. Sura, PMP, PfMP Nicholas Tovar Fede Varchavsky, MBA, PMP Angelo Valle, PhD, CRK Ronald H. Verheijden, PMP X2.4 REVIEWERS X2.4.1 SME REVIEW
  • 710.
    In addition tothe members of the Committee, the following individuals provided their review and recommendations on drafts of the standard: David P. Bieg, PMI-PBA James F. Carilli, PMP, PgMP Shika Carter, PMP, PgMP Dan Deakin, PMP, CISSP Theofanis C. Giotis, PMP, PMI-ACP Dave Gunner, MSc, PMP George Jucan, PMP Ginger Levin, PhD, PMP, PgMP Vanina Mangano, PMP, PMI-RMP Juan Carlos Moreno, MBA, PMP Marvin R. Nelson, MBA, SCPM Klaus Nielsen, MBA, PMP Chris Richards, PMP Ivan Rincon, MBA, PMP Shaligram Pokharel, REng (Nepal), PhD Paul E. Shaltry, MA, PMP Carolina Gabriela Spindola, PMP, SSBB Langeswaran Supramaniam, C Build E FCABE, PMP Michael A Yinger X2.4.2 FINAL EXPOSURE DRAFT REVIEW (STANDARD PORTION) In addition to the members of the Committee, the following individuals provided recommendations for improving the Exposure Draft of the PMBOK® Guide—Sixth Edition (standard portion): Ahmed A. Raouf Hamdy, PhD, PMP Farhad Abdollahyan, PMP, OPM3 CP Adil Abdulghani Tetsuhide Abe, PMP Klaus Abert Ayodeji R. Abitogun, MBA, PMP Taiwo Abraham
  • 711.
    Mohammad I. AbuIrshaid, PMP, PfMP Manuel Acosta A. Phill C. Akinwale, MSc, PMP Mazen Al Bazreh Jose Rafael Alcala Gomez, PMP Ameer Ali Hammam Zayed Alkouz, PMP, PMI-RMP Bill Allbee, PMP Charmaine Y. Allen, PMP, PBA Kristin L. Allen, PE, PMP Abdulaziz Almalki Ayman Alminawi, MBA, PMP Ahmad Moh. Al-Musallami, MSc, PMP Imad Alsadeq, P3M3, MB Mohammed Ahmad S. Al-Shamsi, PhD, PEng Essam Alsultan, MBA, PMP Haluk Altunel, PhD, PMP Priscilla S. R. Alves, PMP Angelo Amaral Barnabas Seth Amarteifio, PMP, ITIL (Expert) Wilson Anandaraj, MBA, PMP Guillermo Anton John Aogon, PMP Hamid Aougab, PMP, PMI-ACP Charalampos Apostolopoulos, PhD, PMP Rodolfo Arguello Abd Razak B Ariffin, PMP Deepak Arora, MBA, PMP C. H. ArunPrabu, PMP Zaher Asfari, MBA, PMI-ACP Ayman Atallah, BE, PMP Reza Atashfaraz, MSc, PMP Sharaf A. Attas, PMP, PMI-RMP Abdurazaq Attuwaijri Ashraf M Awwad, MSc, PMP Vikram Kumar B. T.
  • 712.
    Nabeel Eltyeb Babiker,PMP, P3O Mohamed A Badie, PMP, Prince2 Practitioner Smitha Balakrishnan Saket Bansal, PMP, PMI-ACP Manuel F. Baquero V., MSc, PMP Haytham Baraka, PMP, CCP Robert Barclay Karuna Basu Joy Beatty, PMI-PBA, CBAP Frances Bellows, PMP, ACP Peter G. Bembir, MPhil, PMP Anis Ben Hassen, Msc Project/Programme/Portfolio Management, PMP Racquel Benedict German Bernate, MPM Bryan D. Berthot, MBA, PMP Karl F. Best, PMP, CStd Shantanu Bhamare, PMP, LIMC Jasbir Singh Bhogal, PMP, ITIL-V3 Michael M. Bissonette, MBA, PfMP Molly Blake-Michaels, MS, PMP Nigel Blampied, PE, PMP Wolfgang Blickle, PMP, PMI-ACP Jaqueline Boeck Dennis L. Bolles, PMP Kiron D. Bondale, PMP, PMI-RMP Raúl Borges, PMP Farid F. Bouges, PhD, PMP, PfMP Joao Boyadjian Damiano Bragantini, PMP Ralf Braune Kevin Brennan Naga Pradeep Buddhavarapu, PMP David E. Buehler, PMP Susan M. Burk Andrea Caccamese, PMP, Prince2 Practitioner Roberto A. Cadena Legaspi, PMP, MCI
  • 713.
    Shawna D. Camp,MBA, PMP Iker Castillo, PMP Igor Castro Helena Cedersjö, MSc, PMP Balasubramanian Chandrasekaran, BE, PMP Joo-Kwan Chang Panos Chatzipanos, PhD, Dr Eur Ing Pengzhi Chen, PMP, MSC Wilson Lee Chung, PMP Xavier Clerfeuille, MSc, SSL Black Belt Martin A. Collado, PMP, ITIL Sergio Luis Conte, PhD, PMP Lawrence (Larry) Cooper, PMP, PMI-ACP Hélio R. Costa, DSc Scott Cunningham Adriano Jose da Silva Neves Hernán D'Adamo, MPM, PMP Michelle Daigle, PMP Larry C Dalton, PfMP, PgMP Farshid Damirchilo, MSc Tran Dang Teodor Darabaneanu, PMP, MEng Russell W. Darnall, DM, PMP Edson G. Freitas, PMP Jean-Michel de Jaeger, EMBA, PMP Maria Angela de Souza Fernandes Allan E. Dean PMP, PgMP G. Murat Dengiz, PMP Valerie P. Denney, DBA, PMP Jacqueline E. Dennis, PMP, PgMP Konika Dey, MCA, PMP Cyndi Snyder Dionisio, MBA, PMP Ajay Kumar Dixit, MBA, B Tech Roland Doerr, MSc, PMP Rex Wotan Dominguez Chang Jorge Duenas-Lozano
  • 714.
    Stephen M. Duffield,MPM, CPPD Josée Dufour, PMP Darya Duma, PEng, PMP Keiran J. Dunne, PhD Awab Elameer, PMP, PMI-SP Khaled EL-Nakib, MSc, PMP Yasir Elsadig, PMP, PfMP Majdi N. Elyyan, PMP, PMI-RMP Pedro Engrácia Mark W. Erwin, PMP, PMI-ACP Behnam Faizabadi, PhD, PMP Marco Falcao, PMP, PMI-RMP Puian Masudi Far, PhDc, PMP Jamil Faraj Saurater Faraday, PMI-RMP Fereydoun Fardad, PMP, PRINCE2 Sergio Ferreto Gutiérrez, MPM, MBA David Foley, MBA Les Foley, MPM, PMP Gloria Folle Estrada, PMP Frank P. Forte, PMP Laura Franch, PMP Nestor C. Gabarda Jr., ECE, PMP Jaime Garcia Castro, PMP Sam Ghavanloo, PMP Ing Gustavo Giannattasio MBA, PMP Sheila Gibbs Carl M. Gilbert, PMP PfMP Theofanis Giotis, PhDc, PMP José Abranches Gonçalves, MSc, PMP Juan Carlos González, PMP, PMI-ACP Jean Gouix, PMP, PgMP Therese Graff Scott M. Graffius, PMP, CSM Brian Grafsgaard, PMP, PgMP Sara Grilli Colombo
  • 715.
    Anita Griner Maxim Grishin,PhD, PMP Robert C Grove, MBA, PMP David Guan, PMP Juan E. Guarache, V, BEng, PMP Pier Luigi Guida Vijay Guliani, PMP, PMI-PBA Tomasz Gutmanski Omar Haddad, CAPM, PMP Mustafa Hafizoglu, PMP Yoshifumi Hamamichi Simon Harris, PMP, CGEIT Patti M. Harter, PMP Sean Shraden Hasley, MSIT-PM Ahmed Hassan Akram Hassan, PhD, PMP Susumu Hayakawa, PMP Bruce A. Hayes, PMP Guangcheng He, PMP David G. Hendrickson, PMP Barbara Henrich Baruch Herrera Sergio Herrera-Apestigue, PMP, P3O Robert Hierholtz, PhD, MBA, PMP Robert N. Higgins V, PMP, ITIL Expert David A. Hillson, PhD, PMI Fellow, HonFAPM Shirley Hinton, PMP Kenji Hiraishi, MsE, PMP Lenora Holmsten, PMP, MPM Jenny Anne Horst-Martz, JD, PMP Alfred J. Howard, PMP, ITIL Expert Cynthia L. Hoxey, PMP Gheorghe Hriscu, PMP, CGEIT Ananth HV PMP, CSM Guillermo A. Ibañez, PMP, ITIL Victor Manuel Ibanez Salazar, PMP, MA
  • 716.
    Waleed Idris Shuichi Ikeda,PMP Andrea Innocenti PMP, CGEIT Can Izgi, PMP Pablo Jaramillo Tariq Javed, MS, PMP Cari Jewell, PMP, MISST Gabriela Jimenez P. Icvillajoe Joe Tony Johnson, PMP, PfMP Michele J. Jones, PMP Yves Jordan, PMP Alisher Kabildjanov, PMP SS Kanagaraj, PMP, ITIL Naoki Kasahara, PMP Arcady Katnikov Suhail Khaled Basher Khalil Aaron Ho Khong, PMP, ITIL Expert M. Raashid Kiani, PMP, CSM Taeyoung Kim, PMP Ariel S. Kirshbom, PMP, ACP Konstantinos Kirytopoulos, PhD, PMP Ian Koenig PMP Athens Kolias, MPM, PMP Henry Kondo, PMP, PfMP Maciej Koszykowski, PMP, PMI-RMP Rouzbeh Kotobzadeh, PMP, PMI-ACP Srikanth Krishnamoorthy, PMP, PGDSA Amit Kumar Devesh Kumar Pramit Kumar, PMP Rakesh Kumar, MBA, PMP Santosh Kumar S. Y. Satish Kumar Abhilash Kuzhikat, PMP, CISA
  • 717.
    Thierry Labriet G.Lakshmi Sekhar,PMP, PMI-SP Boon Soon Lam Vincent Hiu Sing Lam, PMP Ruchie Lamba Deborah Langlois MBA, PMP Alvaro Latorre,MsC, PMP Olivier Lazar Chang-Hee Lee, PMP, CISA Cheryl G. Lee, PMP, PMI-PBA Oliver F. Lehmann, MSc, PMP Michael J Leisegang, PMP Craig Letavec, PgMP, PfMP Jean-Pierre Lhomme, PMP Junquan Liu Shihan Liu Tong Liu (James Liu), PhD, PMP Anand Loganathan, MS Anand Lokhande, PMP Nancy Lopez Samuel López González de Murillo, MPM, PMP Carlos López Javier, MBA, PMP Zheng Lou, MBA, PMP Sérgio Lourenço, PMP, PMI-RMP Catia Lourenço Hugo Kleber Magalhães Lourenço, PMP, ACP Amy S. Lugibihl, PMP Sergio O. Lugo, MBA, PMP Vijaya Prasanth M. L., PMP, MCTS José Carlos Machicao, MSc, PMP Frederick G. Mackaden, CRISC, PMP Jas Madhur Krishan Gopal Maheshwari, PMP, ITILv3 Expert Konstantinos Maliakas, MSc (PM), PMP Rich Maltzman, PMP Vaios Maniotis
  • 718.
    Antonio Marino, PMP,PMI-ACP Gaitan Marius Titi, Eng, PMP Photoula Markou-Voskou Lou Marks, PMP Cristian Martín Corrales, MPM, PMP Mike McElroy, MHA, PMP Jon McGlothian, MBA, PMP William T. McNamara, PMP Rob D. Meadows, MBA, PMP Alain Patrick Medenou, PMP, PRINCE2 Practitioner Lourdes Medina, PMP, PfMP Peter Berndt de Souza Mello, PMI-SP, PMP Yan Bello Mendez Ernst Menet, PMP Sunil Meshram, PMP Mohammed M'Hamdi, PMP Lubomira Mihailova, MBA, PMP Gloria J. Miller, PMP Romeo Mitchell, MSc, BSc Mannan Mohammed, Peng, PMP Venkatram Vasi Mohanvasi Ricardo Monteiro Paula Morais Maciej Mordaka, PMP Rachel A. Morris, PMP Doris Moss Henrique Moura, PMP, PMI-RMP Timur Mukharyamov, PhD, PMP Antonio Muntaner, PMP Muktesh Murthy, MBA (IS), PMP Lemya Musa M. Idris, PMP, PMI-PBA Khalid M. Musleh, PMP, PMI-RMP Syed Ahsan Mustaqeem, PE, PMP Todd Nielsen Myers, MBA, PMP Narayanaswamy Nagarajan, PMP Kiran Nalam
  • 719.
    Faig Nasibov, PMP AsadNaveed, PMP, RMP Serge Patrick N'Guessan, MSIS, PMP Praveen K. Nidumolu, PMP, PMI-ACP Eric Nielsen, PMP Jeffrey S. Nielsen, PMP, PgMP Víctor Nieva Martín-Portugués, PMP Michael C. Nollet, PMP, PMI-ACP Takamasa Nomura Ernesto Antonio Noya Carbajal Mufaro M. Nyachoto, PMI-PBA, CAPM Conor O'Brien, MBA (Tech Open), PMP Peter O'Driscoll Michael O. Ogberuhor, PMP, EVP Bayonle Oladoja, PMP, PRINCE2 Antonio Oliva González, PMP, EMPM Habeeb Omar, PgMP, PfMP Stefan Ondek, PMP Marian Oprea, PMP, ITIL Henrique Ortega-Tenorio, PMP Venkateswar Oruganti, FIETE, PMP Musab Abdalmageed Osman Abubakar Jaime Andres Alvarez Ospina, PMP, PMI-RMP Tabitha A. Palmer, PMP Neeraj Pandit, PMP Luke Panezich, PMP, PMI-ACP Hariyo Pangarso Laura Paton, PMP, PMI-PBA Seenivasan Pavanasam, PMP, PgMP Anil Peer, PEng, PMP Mauricio Perez Calvo, PMP, PMI-RMP Dana Persada Mulyoto, MBA, PMP LEE Nan Phin, PMP, CSM Luca Pietrandrea Crispin (“Kik”) Piney, BSc, PgMP Jose Angelo Pinto, PMP, OPM3 CP
  • 720.
    Narendra Pondugula, PMP,PMI-ACP Hin-Fei Poon Svetlana Prahova, PMP B. K. Subramanya Prasad, PMP, CSM T.V. Prasanna Raaj, PMP Suhail Qadir, PMP, BTech Collin Quiring, PMP, OPM3 Nader K. Rad, PMP Noalur Rahim, PMP Prashanth Bagepalli Rajarao, BE, PMP S. Ramani, PgMP, PfMP Gurdev S. Randhawa, PMP Alakananda Rao Vicky Restrepo, PMP Raman Rezaei Tashfeen Riaz, PMP, MPM Juan Carlos Rincón Acuña, PhD, PMP Juan Sebastian Rivera Ortiz Dan Roman, PMP, PMI-ACP Rafael Fernando Ronces Rosas, PMP, ITIL David W. Ross, PMP, PgMP Kaydashov Ruslan, PMP Philip Leslie Russell, PMP Mohamed Salah Eldien Saad, PMP Eyad Saadeh, PfMP, PgMP Imad Sabonji, PMP Kumar Sadasivan, PMP Mihail Sadeanu, PhD, PMP Gopal Sahai, PMP, PMI-PBA Joudi Ahmad Said, PMP, MSc Ibrahim Saig, PhD, PMP, MRCPI Brian Salk, PhD, PMP Omar A. Samaniego, PMP, PMI-RMP Abubaker Sami, PfMP, PgMP Carlos Sánchez Golding, PMP Yiannis Sandis, MSc, PMP
  • 721.
    Iván S. TejeraSantana, PMP, PMI-ACP Murali Santhanam, PMP, BCom Subhendu Sarangi Saikat Sarkar, PMP Shreesh Sarvagya Supriya Saxena Nicole Schelter, PMP Kathy Schwalbe, PhD, PMP Dion Serben Marcus Gregorio Serrano, MBA, PMP Isaac Sethian, MBA, PMP Bruce G. Shapiro, PMP Ian Sharpe, 4-DM CPPD Cindy C Shelton, PMP, PMI-ACP Nitin Shende, PMP, PRINCE2 Gregory P. Shetler, PhD, PgMP Patricia C. C. Sibinelli, MEng, PMP Alexsandro Silva Christopher M. Simonek, PMP Rohit Singh Sathya Sivagurunathan Venkatramanan S., PMP Michelle A. Sobers, MS Pamela L. Soderholm, PMP Khaled Soliman Mauro Sotille, PMP, PMI-RMP Sriram Srinivasan, PMP, CGEIT Pranay Srivastava, PMP, CSM Alexander Stamenov Jamie Stasch John Stenbeck, PMP, PMI-ACP Michael J. Stratton, PhD, PMP S. Sudha, PMP John L. Sullivan, MEd, PMP Karen Z. Sullivan, PMP, PSM Surichaqui Yasuji Suzuki, PMP
  • 722.
    Mark A. Swiderski,PMP, MBA Titus K. Syengo, PMP Paul S. Szwed, DSc, PMP Hadi Tahmasbi Ashtiani Shoji Tajima, PMP, ITC Peter Tashkoff, PMP Ahmet Taspinar Gokrem Tekir Sunil Telkar PMP, PGDBL Sal J. Thompson, MBA, PMP Mark S. Tolbert, PMP, PMI-ACP Mukund Toro, PMP Stephen Tower, PMP, MBCI John Tracy, PMP, MBA Biagio Tramontana, Eng, PMP Micol Trezza, MBA, PMP Konstantin Trunin, PMP Ahmet Tümay, PhD, PMP M. Jeffery Tyler, PMP Hafiz Umar, MBA, PMP Krishnakant T. Upadhyaya, PMP Atta Ur Rahman, MBA, PMP Ebenezer Uy Madhavan V. Ali Vahedi Diz, PgMP, PfMP Tom Van Medegael, PMP Stephen VanArsdale Enid T. Vargas Maldonado, PMP, PMI-PBA Paola D. Vargas Allam V. V. S. Venu, PMP, PgMP Roberto Villa, PMP Tiziano Villa, PMP, PMI-ACP Benjamin Villar Lurquin, Bs Dave Violette, MPM, PMP Vijay Srinivas Vittalam PMP, RMP Julian Vivas
  • 723.
    Sameh Wahba, PMP,CPMC Prakash Waknis, PMP Xiaojin Wang, PhD, PMP Tsunefumi Watanabe, PMP Barbara A. Waters, MBA, PMP Shayla P. Watson, MA Patrick Weaver, PMP, PMI-SP Kevin R. Wegryn, PMP, Security+ Lars Wendestam, MSc, PMP Jan Werewka, PMP Carol E. P. Whitaker, MBA, PMP Sean Whitaker, MBA, PMP Angela Wick, PMP, PBA Michal P. Wieteska J. Craig Williams Malgorzata Wolny Sek-Kay Steve Wong, MBA, PMP Louise M. Worsley Yan Wu, APME, PMP Clement C. L. Yeung, PMP Cynthia J. Young, PhD, PMP, LSSMBB Gordon Young Alan E. Yue, PMP, PMI-ACP Hany I. Zahran Saeed Zamani Alessandri Zapata Rosas, PMP Azam M. Zaqzouq, MCT, PMP Salim Zid, MSc, PMP Eire Emilio Zimmermann Marcin Zmigrodzki, PhD, PgMP X2.4.3 FINAL EXPOSURE DRAFT REVIEW (GUIDE PORTION) In addition to the members of the Committee, the following individuals provided recommendations for improving the Exposure Draft of the PMBOK® Guide—Sixth Edition (guide portion):
  • 724.
    Farhad Abdollahyan, PMP,OPM3CP Tetsuhide Abe, PMP Ali Abedi, PhD, PMP Amir Mansour Abdollahi, MSc, PE Eric Aboagye Umesh AC Jer Adamsson Carles Adell, MPM, PMP Mounir A. Ajam, RMP, GPM-bTM Uğur Aksoylu, PMP Tarik Al Hraki, PMP, PMI-RMP Melad Al Aqra, PMP, MIET Amer Albuttma, BSc, PMP Jose Rafael Alcala Gomez, PMP Filippo Alessandro, PMP Hammam Zayed Alkouz, PMP, PMI-RMP Eric Allen Wasel A. Al-Muhammad, MBA, PMP Turki Mohammed Alqawsi, MITM Imad Alsadeq, MB, P3M3 Haluk Altunel, PhD, PMP Barnabas Seth Amarteifio, PMP, ITIL (Expert) Serge Amon, MBA, PMP Abd Razak B Ariffin, PMP Sridhar Arjula Kalpesh Ashar, PMP, PMI-ACP Vijaya C. Avula, PMP, ACP Andy Bacon, PMP, CSP Andrey Badin Sherif I. Bakr, PMP, MBA Karuna Basu Chandra Beaveridge, BEng, PMP Jane Alam Belgaum, PMP Stefan Bertschi, PhD Harwinder Singh Bhatia, PMP, PMI-ACP Jasbir Singh Bhogal, PMP, ITIL-V3
  • 725.
    Jayaram Bhogi PMP,CSM Michael M. Bissonette, MBA, MS Greta Blash, PMP, PMI-ACP Steve Blash, PMP, PMI-ACP Dennis L. Bolles, PMP Rodolphe Boudet, PMP Farid F. Bouges, PhD, PfMP, PMP Damiano Bragantini, PMP Ralf Braune, PhD, PMP Maria del Carmen Brown, PMP James N. Bullock, PMP, ASQ CMQ/OE Andy Burns PMP, PMI-ACP Nicola Bussoni, PMP Roberto A. Cadena Legaspi, PMP, MCI Carla M. Campion, BEng (Hons), PMP Shika Carter, PMP, PgMP Luis Casacó, MA, PMP Guillermo A. Cepeda L., PMP, PMI-RMP Kristine Chapman Panos Chatzipanos, PhD, Dr Eur Eng. Satish Chhiba Aditya Chinni Virgiliu Cimpoeru, PhDc, PMP Jorge Omar Clemente, PMP, CPA Martin A. Collado, PMP, ITIL Sergio Luis Conte, PhD, PMP Franco Cosenza, PGDipBA, PMP Veronica Cruz Ron Cwik MBA, PMP Yudha P. Damiat, PMP, PMI-SP Farshid Damirchilo, MSc William H. Dannenmaier, PMP, MBA Sankalpa Dash Gina Davidovic PMP, PgMP Beatriz Benezra Dehtear, MBA G. Murat Dengiz, PMP
  • 726.
    Stephen A. Devaux,PMP, MSPM Shanmugasundaram Dhandapani Sachin S. Dhaygude, PMP, PMI-ACP Ivana Dilparic Marcelo Sans Dodson, DBA,PMP Nedal A. Dudin, PMP, PBA Jorge A. Dueñas, PMP, AVS Eunice Duran Tapia, PMP, PfMP Wael K. Elmetwaly, PMP, PMI-ACP Talha M. El-Gazzar, PMP Carol Elliott, MBA, PMP Larry Elwood, PMP, CISSP Angela England Marco Falcao, PMP, PMI-RMP Puian Masudi Far, PhDc, PMP Jared Farnum Jose L. Fernandez-Sanchez, PhD Eduardo S. Fiol, PMP Regis Fitzgibbon Garry Flemings Carlos Augusto Freitas, CAPM, PMP Scott J. Friedman, PMP, ACG MAG Sanaa Fuchs Nestor C. Gabarda Jr., ECE, PMP Robert M. Galbraith, PMP Carl M. Gilbert, PMP, PfMP Theofanis Giotis, PhDc, PMP Dhananjay Gokhale José Abranches Gonçalves, MSc, PMP Herbert G. Gonder, PMP Edward Gorni, PMP, MSc Julie Grabb PMP, B Math Stuart Gray Christiane Gresse von Wangenheim, Dr. rer. nat., PMP Grzegorz Grzesiak Ahmed Guessous, PMP
  • 727.
    Neeraj Gupta, PMP,CSM Sunita Gupta Raj Guttha PhD, PMP Mustafa Hafizoglu, PMP Kazuro Haga, PMP, PMI-RMP Yoshifumi Hamamichi Simon Harris, PMP, CGEIT Gabrielle B. Haskins, PMP Hossam Hassan Madhavi Hawa, MBA Randell R. Hayes II, PMP, MBA Guangcheng He, PMP Kym Henderson, RFD, MSc (Comp) Sergio Herrera-Apestigue, PMP, P3O Robert Hierholtz, PhD, MBA, PMP Bob Hillier, PMP Aaron Ho Khong, PMP, ITIL Expert Scott C. Holbrook, PMP, CISSP Regina Holzinger, PhD, PMP Christina M. House, MBA, PMP Gheorghe Hriscu, PMP, CGEIT Terri Anne Iacobucci, SPHR, PMP Guillermo A. Ibañez, PMP, ITIL Can Izgi, PMP Anand Jayaraman PMP, MCA Anil K. Jayavarapu, PMP Cari Jewell, PMP, MISST Martina Jirickova Alan John Tony Johnson, PMP, PfMP Michele J. Jones, PMP Rajesh G. Kadwe, PMP Orhan Kalayci, PMP, CBAP Samer Faker Kamal, PMP, LEED AP BD+C Surendran Kamalanathan Vaijayantee Kamat, PMP
  • 728.
    Nils Kandelin Carl Karshagen,PMP Anton Kartamyshev Scott Kashkin, MS, PMP Katsuichi Kawamitsu, PMP, ITC Rachel V. Keen, PMP Suhail Khaled Jamal Khalid Eng. Ahmed Samir Khalil, PMP, OPM3-CP Basher Khalil Ranga Raju Kidambi Mostafa K. Kilani, BEng, PMP Diwakar Killamsetty Taeyoung Kim, PMP Konstantinos Kirytopoulos, PhD, PMP Kashinath Kodliwadmanth Maarten Koens, PMP Dwaraka Ramana Kompally, MBA, PMP Henry Kondo, PMP, PfMP Maciej Koszykowski, PMP, PMI-RMP Ahmed A F Krimly Srikanth Krishnamoorthy, PMP, PGDSA Bret Kuhne Avinash Kumar, PMP Pramit Kumar, PMP Thomas M. Kurihara Andrew Lakritz Boon Soon Lam Luc R. Lang PMP Jon Lazarus Chang-Hee Lee PMP, CISA Ivan Lee PMP, PMI-ACP Oliver F. Lehmann, MSc, PMP Katherine A. Leigh Donald LePage Peter Liakos, PMP, Cert APM
  • 729.
    Tong Liu, PhD,PMP Chandra Sekhar Lolla Venkata Satya Stefania Lombardi, PhDc, PMP Daniel D. Lopez, CSP, PMP Zheng Lou, MBA, PMP Sérgio Lourenço, PMP, PMI-RMP Hugo Kleber Magalhães Lourenço, PMP, ACP Xiang Luo, PMP, PMI-PBA José Carlos Machicao, PMP, MSc Sowjanya Machiraju, MS, PMP Robert Mahler Mostafa M. Abbas, PMP, OCE Konstantinos Maliakas, MSc (PM), PMP Rich Maltzman, PMP Ammar Mango Antonio Marino, PMP, PMI-ACP Gaitan Marius Titi, Eng, PMP Lou Marks, PMP Rodrigo Marques da Rocha Ronnie Maschk, PMP Maria T Mata-Sivera, PMP Kurisinkal Mathew Stephen J. Matney, CEM, PMP David A. Maynard, MBA, PMP Pierre Mbeniyaba Mboundou Thomas McCabe Jon McGlothian, MBA, PMP Alan McLoughlin, PMP, PMI-ACP Ernst Menet, PMP Mohammed M'Hamdi, PMP Roberta Miglioranza, PMP, Prince2 Gloria J. Miller, PMP Daniel Minahan, MSPM, PMP Javier A Miranda, PMP, PMI-ACP Saddam Mohammed Babikr Mohammed Venkatramvasi Mohanvasi, PMP
  • 730.
    Maciej Mordaka, PMP PaolaMorgese, PMP Moises Moshinsky, MSc, PMP Henrique Moura, PMP, PMI-RMP Nathan Mourfield Alison K. Munro, MSc, PMP Khalid M. Musleh, PMP, PMI-RMP Vasudev Narayanan Faig Nasibov, PMP Daud Nasir, PMP, LSSBB Nasrullah Nghi M. Nguyen, PhD, PMP Eric Nielsen, PMP Yamanta Raj Niroula, PMP Emily Nyindodo Peter O'Driscoll Kiyohisa Okada Bayonle Oladoja, PMP, PRINCE2 Sofia Olguin Edward C. Olszanowski III, PMP, EMBA Austen B. Omonyo, PhD, PMP Stefan Ondek, PMP Tom Oommen H. Metin Ornek, PMP, MBA Juan Carlos Pacheco Durgadevi S. Padmanaban, MBA, PMP Ravindranath Palahalli Boopathy Pallavapuram, PMP Rajeev R. Pandey Luke Panezich, PMP, PMI-ACP Sungjoon Park, PMP Gino Parravidino Jacobo, PMP, ITIL Richard L. Pascoe, PMP George Pasieka, PMP Sneha Patel, PMP Satyabrata Pati, PMP
  • 731.
    Seenivasan Pavanasam PMP,PgMP R. Anthoney Pavelich, PMP P. B. Ramesh, PMP, ACP Brent C. Peters, BA Yvan Petit, PhD, PMP Crispin (“Kik”) Piney, BSc, PgMP Jose Angelo Pinto, PMP, OPM3 CP Napoleón Posada, MBA, PMP B K Subramanya Prasad, PMP, CSM Carl W. Pro, PMP, PMI-RMP Srikanth PV Nader K. Rad, PMP Karen Rainford, EdD, PMP S. Ramani, PfMP, PgMP Niranjana Koodavalli Ramaswamy, BE Mech, PGDM Jesus Esteban Ramirez, BEng, eCS Michele Ranaldo, PMP Gurdev S. Randhawa, PMP Sreekiran K. Ranganna, PMP, MBA Alakananda Rao Muhammad Sauood ur Rauf, PMP P. Ravikumar, PMP, PMI-ACP Michael Reed, PMP, PfMP Messias Reis, PMP Alexander V. Revin, PMP Mohammadreza Rezaei Gustavo Ribas David B. Rich, PMP Gregg D. Richie, PMP, MCTS Edgar Robleto Cuadra Bernard Roduit David Roe, PMP Rafael Fernando Ronces Rosas, PMP, ITIL Prakash Roshan William S. Ruggles, PMP, CSSMBB Nagy Attalla Saad, PMP, ITIL
  • 732.
    Natesa Sabapathy, PhD,PMP Kumar Sadasivan, PMP Dzhamshid Safin, PhD, PMP Edgardo S. Safranchik, PMP Ibrahim Mohammed Ali Saig Naoto Sakaue Xavier Salas Ceciliano, MSc, PMP Anderson Sales Floriano Salvaterra, PMP, IPMA-C Omar A. Samaniego, PMP, PMI-RMP Abubaker Sami, PfMP, PgMP Angela Sammon P. Sampathkumar, MBA, PMP Iván S. Tejera Santana, PMP, PMI-ACP Luciana de Jesus Santos, PMP Aminu Sarafa, PMP, CCP Darpan Saravia, PMP, CSM Tamara Scatcherd Stephen M. Schneider, PhD, PMP Ludwig Schreier, Eur Ing, PMP Birgitte Sharif, PMP Sanjeev Sharma Alexander Shavrin, PhD, PMP Nitin Shende, PMP, PRINCE2 Luqman Shantal, PMP, TOGAF N. K. Shrivastava, PMP, SPC4 Mohamad Sibai Gustavo Silva Sumit Kumar Sinha, PMP Ronald Zack Sionakides, MBA, PMP Klas Skogmar, EMBA, PMP J. Greg Smith, EVP Kenneth F. Smith, PhD, PMP Pamela L. Soderholm, PMP John Paul Soltesz Sheilina Somani, RPP, PMP
  • 733.
    Mauro Sotille, PMP,PMI-RMP Setty Sreelatha, PMP, PMI-ACP Shishir Srivastav, PMP, CSM Pranay Srivastava, PMP, CSM John Stenbeck, PMP, PMI-ACP Jim Stewart Yasuji Suzuki, PMP Mark A. Swiderski, PMP, MBA Ahmed Taha, PMP, PMI-RMP Francis Taiwo, PMP, PMI-ACP Yahya Tatar, PMP, MBA Gerhard J. Tekes, PMP, PMI-RMP Gokrem Tekir João Paulo Tinoco Claudia A. Tocantins, MSc, PMP Mukund Toro, PMP Juan Torres Vela Stephen Tower, PMP, MBCI Brenda Tracy John Tracy, MBA, PMP Konstantin Trunin, PMP Tassos Tsochataridis, MSc, PMP Krishnakant T. Upadhyaya, PMP Ali Vahedi Diz, PgMP, PfMP Jorge Valdés Garciatorres, PMP, SMC Jose Felix Valdez-Torero, PMP Tom Van Medegael, PMP Raymond Z van Tonder, PMP, ND Elec Eng Ravi Vanukuru, BE, PMP Ricardo Viana Vargas, MSc, PMP Neelanshu Varma, PMP Debbie Varn, PMP, SHRM-SCP Vijay Vemana, PgMP, PMP Nagesh V., PMP Aloysio Vianna Jr., DEng, PMP Roberto Villa, PMP
  • 734.
    Jorge Villanueva, MSc(PM), PMP Dave Violette, MPM, PMP Yiannis Vithynos PMP, PMI-ACP Steve Waddell, MBA, PMP Xiaojin Wang, PhD, PMP J. LeRoy Ward, PMP, PgMP Toshiyuki Henry Watanabe, PE, PMP Ashleigh Waters, PMP Ganesh Watve, MBA, PMP Patrick Weaver, PMP, PMI-SP Michal P. Wieteska Roger Wild, PMP Rebecca A. Winston, JD Lisa Wolf Carlos Magno Xavier, PhD, PMP Wenyi Xiao, PMP Haotian Xu, CAPM Clement C. L. Yeung, PMP Saeed Zamani Azam M. Zaqzouq, MCT, PMP Omran M. Zbeida, PMP, BSP Marcin Zmigrodzki, PMP, PgMP Rolf Dieter Zschau, PMP Alan Zucker, PMP, CSM X2.5 PMI STANDARDS PROGRAM MEMBER ADVISORY GROUP (MAG) The following individuals served as members of the PMI Standards Program Member Advisory Group during development of the PMBOK® Guide—Sixth Edition: Maria Cristina Barbero, PMP, PMI-ACP Brian Grafsgaard, PMP, PgMP Hagit Landman, PMP, PMI-SP Yvan Petit, PhD, PMP
  • 735.
    Chris Stevens, PhD DaveViolette, MPM, PMP John Zlockie, MBA, PMP, PMI Standards Manager X2.6 CONSENSUS BODY REVIEW The following individuals served as members of the PMI Standards Program Consensus Body: Nigel Blampied, PE, PMP Dennis L. Bolles, PMP Chris Cartwright, MPM, PMP Sergio Coronado, PhD Andrea Demaria, PMP John L. Dettbarn, Jr., DSc, PE Charles T. Follin, PMP Laurence Goldsmith, MBA, PMP Dana J Goulston, PMP Brian Grafsgaard, PMP, PgMP David Gunner, PMP Dorothy L. Kangas, PMP Thomas Kurihara Hagit Landman, PMP, PMI-SP Timothy MacFadyen Harold “Mike” Mosley, Jr., PE, PMP Eric S Norman, PMP, PgMP Nanette Patton, MSBA, PMP Yvan Petit, PhD, PMP Crispin (“Kik”) Piney, BSc, PgMP Michael Reed, PMP, PfMP David W. Ross, PMP, PgMP Paul E. Shaltry, PMP Chris Stevens, PhD Adam D. Sykes, MS, PMP Matthew D. Tomlinson, PMP, PgMP Dave Violette, MPM, PMP
  • 736.
    X2.7 PRODUCTION STAFF Specialmention is due to the following employees of PMI: Donn Greenberg, Manager, Publications Roberta Storer, Product Editor Barbara Walsh, Publications Production Supervisor †Deceased. The core committee and PMI acknowledge Michael J. Stratton for his work on the PMBOK Guide-Sixth Edition. Mike was dedicated to the profession and this work is a testament of his contributions to the field of project management.
  • 737.
    APPENDIX X3 AGILE, ITERATIVE,ADAPTIVE, AND HYBRID PROJECT ENVIRONMENTS This appendix explores the nuances of how the Project Management Process Groups described in The Standard for Project Management are performed with respect to the project environment and life cycle. Section 1.4.2.1 of the PMBOK® Guide states that the “project life cycle needs to be flexible enough to deal with the variety of factors included in the project.” It is the nature of projects to evolve as more detailed and specific information becomes available. This ability to evolve and adapt is more relevant in environments with a high degree of change and uncertainty or with a wide variation of stakeholder interpretation and expectations. X3.1 THE CONTINUUM OF PROJECT LIFE CYCLES To understand the application of the process in adaptive projects, the continuum of project life cycles should be defined. The PMBOK® Guide Glossary describes the project life cycle as “the series of phases that a project passes t
