I
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
Table of Contents
1. Introduction...................................................................................................................... 1
1.1 Purpose of the PMBOK®
Guide................................................................................. 2

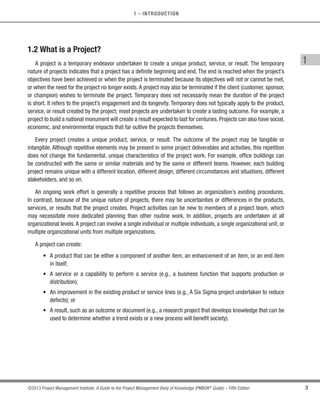

1.2 What is a Project?....................................................................................................... 3
1.2.1. The Relationships Among Portfolios, Programs, and Projects..................... 4
1.3 What is Project Management?.................................................................................... 5
1.4 Relationships Among Portfolio Management, Program Management, Project
Management, and Organizational Project Management............................................ 7
1.4.1 Program Management.................................................................................... 9
1.4.2 Portfolio Management..................................................................................... 9
1.4.3 Projects and Strategic Planning................................................................... 10
1.4.4 Project Management Office.......................................................................... 10
1.5 Relationship Between Project Management, Operations Management, and
Organizational Strategy............................................................................................. 12
1.5.1 Operations and Project Management........................................................... 12
1.5.2 Organizations and Project Management...................................................... 14
1.6 Business Value.......................................................................................................... 15
1.7 Role of the Project Manager...................................................................................... 16
1.7.1 Responsibilities and Competencies of the Project Manager....................... 17
1.7.2 Interpersonal Skills of a Project Manager.................................................... 17
1.8 Project Management Body of Knowledge................................................................ 18
2. ORGANIZATIONAL INFLUENCES AND PROJECT LIFE CYCLE............................................... 19
2.1 Organizational Influences on Project Management................................................. 20
2.1.1 Organizational Cultures and Styles.............................................................. 20
2.1.2 Organizational Communications.................................................................. 21
2.1.3 Organizational Structures............................................................................. 21
2.1.4 Organizational Process Assets..................................................................... 27
2.1.5 Enterprise Environmental Factors................................................................ 29
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
II ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
2.2 Project Stakeholders and Governance..................................................................... 30
2.2.1 Project Stakeholders..................................................................................... 30
2.2.2 Project Governance....................................................................................... 34
2.2.3 Project Success............................................................................................. 35
2.3 Project Team.............................................................................................................. 35
2.3.1 Composition of Project Teams...................................................................... 37
2.4 Project Life Cycle....................................................................................................... 38
2.4.1 Characteristics of the Project Life Cycle...................................................... 38
2.4.2 Project Phases............................................................................................... 41
3. PROJECT MANAGEMENT PROCESSES................................................................................ 47
3.1 Common Project Management Process Interactions............................................... 50
3.2 Project Management Process Groups...................................................................... 52
3.3 Initiating Process Group............................................................................................ 54
3.4 Planning Process Group............................................................................................ 55
3.5 Executing Process Group.......................................................................................... 56
3.6 Monitoring and Controlling Process Group.............................................................. 57
3.7 Closing Process Group.............................................................................................. 57
3.8 Project Information.................................................................................................... 58
3.9 Role of the Knowledge Areas.................................................................................... 60
4. PROJECT INTEGRATION MANAGEMENT.............................................................................. 63
4.1 Develop Project Charter............................................................................................ 66
4.1.1 Develop Project Charter: Inputs.................................................................... 68
4.1.2 Develop Project Charter: Tools and Techniques........................................... 71
4.1.3 Develop Project Charter: Outputs................................................................. 71
4.2 Develop Project Management Plan........................................................................... 72
4.2.1 Develop Project Management Plan: Inputs.................................................. 74
4.2.2 Develop Project Management Plan: Tools and Techniques......................... 76
4.2.3 Develop Project Management Plan: Outputs................................................ 76
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
III
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
4.3 Direct and Manage Project Work.............................................................................. 79
4.3.1 Direct and Manage Project Work: Inputs..................................................... 82
4.3.2 Direct and Manage Project Work: Tools and Techniques............................ 83
4.3.3 Direct and Manage Project Work: Outputs................................................... 84
4.4 Monitor and Control Project Work............................................................................ 86
4.4.1 Monitor and Control Project Work: Inputs.................................................... 88
4.4.2 Monitor and Control Project Work: Tools and Techniques........................... 91
4.4.3 Monitor and Control Project Work: Outputs................................................. 92
4.5 Perform Integrated Change Control.......................................................................... 94
4.5.1 Perform Integrated Change Control: Inputs................................................. 97
4.5.2 Perform Integrated Change Control: Tools and Techniques........................ 98
4.5.3 Perform Integrated Change Control: Outputs............................................... 99
4.6 Close Project or Phase............................................................................................ 100
4.6.1 Close Project or Phase: Inputs.................................................................... 102
4.6.2 Close Project or Phase: Tools and Techniques........................................... 102
4.6.3 Close Project or Phase: Outputs................................................................. 103
5. PROJECT SCOPE MANAGEMENT....................................................................................... 105
5.1 Plan Scope Management......................................................................................... 107
5.1.1 Plan Scope Management: Inputs................................................................ 108
5.1.2 Plan Scope Management: Tools and Techniques....................................... 109
5.1.3 Plan Scope Management: Outputs............................................................. 109
5.2 Collect Requirements.............................................................................................. 110
5.2.1 Collect Requirements: Inputs..................................................................... 113
5.2.2 Collect Requirements: Tools and Techniques............................................ 114
5.2.3 Collect Requirements: Outputs................................................................... 117
5.3 Define Scope............................................................................................................ 120
5.3.1 Define Scope: Inputs................................................................................... 121
5.3.2 Define Scope: Tools and Techniques.......................................................... 122
5.3.3 Define Scope: Outputs................................................................................. 123
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
IV ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
5.4 Create WBS.............................................................................................................. 125
5.4.1 Create WBS: Inputs..................................................................................... 127
5.4.2 Create WBS: Tools and Techniques............................................................ 128
5.4.3 Create WBS: Outputs................................................................................... 131
5.5 Validate Scope......................................................................................................... 133
5.5.1 Validate Scope: Inputs................................................................................ 134
5.5.2 Validate Scope: Tools and Techniques....................................................... 135
5.5.3 Validate Scope: Outputs.............................................................................. 135
5.6 Control Scope.......................................................................................................... 136
5.6.1 Control Scope: Inputs.................................................................................. 138
5.6.2 Control Scope: Tools and Techniques......................................................... 139
5.6.3 Control Scope: Outputs............................................................................... 139
6. PROJECT TIME MANAGEMENT.......................................................................................... 141
6.1 Plan Schedule Management.................................................................................. 145
6.1.1 Plan Schedule Management: Inputs........................................................... 146
6.1.2 Plan Schedule Management: Tools and Techniques.................................. 147
6.1.3 Plan Schedule Management: Outputs........................................................ 148
6.2 Define Activities....................................................................................................... 149
6.2.1 Define Activities: Inputs.............................................................................. 150
6.2.2 Define Activities: Tools and Techniques..................................................... 151
6.2.3 Define Activities: Outputs........................................................................... 152
6.3 Sequence Activities................................................................................................. 153
6.3.1 Sequence Activities: Inputs........................................................................ 154
6.3.2 Sequence Activities: Tools and Techniques............................................... 156
6.3.3 Sequence Activities: Outputs...................................................................... 159
6.4 Estimate Activity Resources................................................................................... 160
6.4.1 Estimate Activity Resources: Inputs........................................................... 162
6.4.2 Estimate Activity Resources: Tools and Techniques.................................. 164
6.4.3 Estimate Activity Resources: Outputs........................................................ 165
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
V
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
6.5 Estimate Activity Durations..................................................................................... 165
6.5.1 Estimate Activity Durations: Inputs............................................................ 167
6.5.2 Estimate Activity Durations: Tools and Techniques................................... 169
6.5.3 Estimate Activity Durations: Outputs......................................................... 172
6.6 Develop Schedule.................................................................................................... 172
6.6.1 Develop Schedule: Inputs........................................................................... 174
6.6.2 Develop Schedule: Tools and Techniques.................................................. 176
6.6.3 Develop Schedule: Outputs......................................................................... 181
6.7 Control Schedule..................................................................................................... 185
6.7.1 Control Schedule: Inputs............................................................................. 187
6.7.2 Control Schedule: Tools and Techniques.................................................... 188
6.7.3 Control Schedule: Outputs.......................................................................... 190
7. PROJECT COST MANAGEMENT......................................................................................... 193
7.1 Plan Cost Management........................................................................................... 195
7.1.1 Plan Cost Management: Inputs................................................................... 196
7.1.2 Plan Cost Management: Tools and Techniques.......................................... 198
7.1.3 Plan Cost Management: Outputs................................................................ 198
7.2 Estimate Costs......................................................................................................... 200
7.2.1 Estimate Costs: Inputs................................................................................ 202
7.2.2 Estimate Costs: Tools and Techniques....................................................... 204
7.2.3 Estimate Costs: Outputs.............................................................................. 207
7.3 Determine Budget.................................................................................................... 208
7.3.1 Determine Budget: Inputs........................................................................... 209
7.3.2 Determine Budget: Tools and Techniques.................................................. 211
7.3.3 Determine Budget: Outputs........................................................................ 212
7.4 Control Costs........................................................................................................... 215
7.4.1 Control Costs: Inputs................................................................................... 216
7.4.2 Control Costs: Tools and Techniques.......................................................... 217
7.4.3 Control Costs: Outputs................................................................................ 225
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
VI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
8. PROJECT QUALITY MANAGEMENT.................................................................................... 227
8.1 Plan Quality Management....................................................................................... 231
8.1.1 Plan Quality Management: Inputs.............................................................. 233
8.1.2 Plan Quality Management: Tools and Techniques..................................... 235
8.1.3 Plan Quality Management: Outputs............................................................ 241
8.2 Perform Quality Assurance..................................................................................... 242
8.2.1 Perform Quality Assurance: Inputs............................................................. 244
8.2.2 Perform Quality Assurance: Tools and Techniques.................................... 245
8.2.3 Perform Quality Assurance: Outputs.......................................................... 247
8.3 Control Quality......................................................................................................... 248
8.3.1 Control Quality: Inputs................................................................................ 250
8.3.2 Control Quality: Tools and Techniques....................................................... 252
8.3.3 Control Quality: Outputs.............................................................................. 252
9. PROJECT HUMAN RESOURCE MANAGEMENT................................................................... 255
9.1 Plan Human Resource Management....................................................................... 258
9.1.1 Plan Human Resource Management: Inputs.............................................. 259
9.1.2 Plan Human Resource Management: Tools and Techniques..................... 261
9.1.3 Plan Human Resource Management: Outputs........................................... 264
9.2 Acquire Project Team.............................................................................................. 267
9.2.1 Acquire Project Team: Inputs...................................................................... 269
9.2.2 Acquire Project Team: Tools and Techniques............................................. 270
9.2.3 Acquire Project Team: Outputs................................................................... 272
9.3 Develop Project Team.............................................................................................. 273
9.3.1 Develop Project Team: Inputs..................................................................... 274
9.3.2 Develop Project Team: Tools and Techniques............................................ 275
9.3.3 Develop Project Team: Outputs................................................................... 278
9.4 Manage Project Team.............................................................................................. 279
9.4.1 Manage Project Team: Inputs..................................................................... 281
9.4.2 Manage Project Team: Tools and Techniques............................................ 282
9.4.3 Manage Project Team: Outputs................................................................... 284
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
VII
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
10. PROJECT COMMUNICATIONS MANAGEMENT................................................................. 287
10.1 Plan Communications Management..................................................................... 289
10.1.1 Plan Communications Management: Inputs............................................ 290
10.1.2 Plan Communications Management: Tools and Techniques................... 291
10.1.3 Plan Communications Management: Outputs..........................................296
10.2 Manage Communications..................................................................................... 297
10.2.1 Manage Communications: Inputs............................................................. 299
10.2.2 Manage Communications: Tools and Techniques.................................... 300
10.2.3 Manage Communications: Outputs.......................................................... 301
10.3 Control Communications....................................................................................... 303
10.3.1 Control Communications: Inputs.............................................................. 304
10.3.2 Control Communications: Tools and Techniques..................................... 306
10.3.3 Control Communications: Outputs............................................................ 307
11. PROJECT RISK MANAGEMENT........................................................................................ 309
11.1 Plan Risk Management......................................................................................... 313
11.1.1 Plan Risk Management: Inputs................................................................. 314
11.1.2 Plan Risk Management: Tools and Techniques........................................ 315
11.1.3 Plan Risk Management: Outputs.............................................................. 316
11.2 Identify Risks......................................................................................................... 319
11.2.1 Identify Risks: Inputs................................................................................ 321
11.2.2 Identify Risks: Tools and Techniques....................................................... 324
11.2.3 Identify Risks: Outputs.............................................................................. 327
11.3 Perform Qualitative Risk Analysis........................................................................ 328
11.3.1 Perform Qualitative Risk Analysis: Inputs................................................ 329
11.3.2 Perform Qualitative Risk Analysis: Tools and Techniques....................... 330
11.3.3 Perform Qualitative Risk Analysis: Outputs............................................. 333
11.4 Perform Quantitative Risk Analysis...................................................................... 333
11.4.1 Perform Quantitative Risk Analysis: Inputs............................................. 335
11.4.2 Perform Quantitative Risk Analysis: Tools and Techniques.................... 336
11.4.3 Perform Quantitative Risk Analysis: Outputs........................................... 341
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
VIII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
11.5 Plan Risk Responses............................................................................................. 342
11.5.1 Plan Risk Responses: Inputs.................................................................... 343
11.5.2 Plan Risk Responses: Tools and Techniques........................................... 343
11.5.3 Plan Risk Responses: Outputs.................................................................. 346
11.6 Control Risks......................................................................................................... 349
11.6.1 Control Risks: Inputs................................................................................. 350
11.6.2 Control Risks: Tools and Techniques........................................................ 351
11.6.3 Control Risks: Outputs.............................................................................. 353
12. PROJECT PROCUREMENT MANAGEMENT....................................................................... 355
12.1 Plan Procurement Management........................................................................... 358
12.1.1 Plan Procurement Management: Inputs................................................... 360
12.1.2 Plan Procurement Management: Tools and Techniques.......................... 365
12.1.3 Plan Procurement Management: Outputs................................................ 366
12.2 Conduct Procurements.......................................................................................... 371
12.2.1 Conduct Procurements: Inputs................................................................. 373
12.2.2 Conduct Procurements: Tools and Techniques........................................ 375
12.2.3 Conduct Procurements: Outputs.............................................................. 377
12.3 Control Procurements........................................................................................... 379
12.3.1 Control Procurements: Inputs................................................................... 381
12.3.2 Control Procurements: Tools and Techniques.......................................... 383
12.3.3 Control Procurements: Outputs................................................................ 384
12.4 Close Procurements.............................................................................................. 386
12.4.1 Close Procurements: Inputs...................................................................... 388
12.4.2 Close Procurements: Tools and Techniques............................................. 388
12.4.3 Close Procurements: Outputs................................................................... 389
13. PROJECT STAKEHOLDER MANAGEMENT........................................................................ 391
13.1 Identify Stakeholders............................................................................................ 393
13.1.1 Identify Stakeholders: Inputs.................................................................... 394
13.1.2 Identify Stakeholders: Tools and Techniques........................................... 395
13.1.3 Identify Stakeholders: Outputs................................................................. 398
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
IX
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
TABLE OF CONTENTS
13.2 Plan Stakeholder Management............................................................................. 399
13.2.1 Plan Stakeholder Management: Inputs.................................................... 400
13.2.2 Plan Stakeholder Management: Tools and Techniques........................... 401
13.2.3 Plan Stakeholder Management: Outputs.................................................. 403
13.3 Manage Stakeholder Engagement........................................................................ 404
13.3.1 Manage Stakeholder Engagement: Inputs............................................... 406
13.3.2 Manage Stakeholder Engagement: Tools and Techniques...................... 407
13.3.3 Manage Stakeholder Engagement: Outputs............................................. 408
13.4 Control Stakeholder Engagement......................................................................... 409
13.4.1 Control Stakeholder Engagement: Inputs................................................ 411
13.4.2 Control Stakeholder Engagement: Tools and Techniques....................... 412
13.4.3 Control Stakeholder Engagement: Outputs.............................................. 413
ANNEX A1 THE STANDARD FOR PROJECT MANAGEMENT OF A PROJECT........................... 417
APPENDIX X1 FIFTH EDITION CHANGES............................................................................... 463
Appendix X2 Contributors and Reviewers of the PMBOK®
Guide –
Fifth Edition....................................................................................................................... 483
APPENDIX X3 INTERPERSONAL SKILLS................................................................................ 513
REFERENCES......................................................................................................................... 521
Glossary............................................................................................................................. 523
INDEX.................................................................................................................................... 569
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XI
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
List of TABLES and Figures
Figure 1-1. Portfolio, Program, and Project Management Interactions.................................................5
Figure 2-1. Functional Organization.....................................................................................................22
Figure 2-2. Weak Matrix Organization..................................................................................................23
Figure 2-3. Balanced Matrix Organization............................................................................................24
Figure 2-4. Strong Matrix Organization................................................................................................24
Figure 2-5. Projectized Organization....................................................................................................25
Figure 2-6. 	Composite Organization.....................................................................................................26
Figure 2-7. 	The Relationship Between Stakeholders and the Project.................................................31
Figure 2-8. 	Typical Cost and Staffing Levels Across a Generic Project Life Cycle Structure.............39
Figure 2-9. Impact of Variable Based on Project Time........................................................................40
Figure 2-10. Example of a Single-Phase Project....................................................................................42
Figure 2-11. Example of a Three-Phase Project.....................................................................................43
Figure 2-12. Example of a Project with Overlapping Phases.................................................................43
Figure 2-13. Example of Predictive Life Cycle........................................................................................44
Figure 3-1. Project Management Process Groups................................................................................50
Figure 3-2. Process Groups Interact in a Phase or Project..................................................................51
Figure 3-3. Project Management Process Interactions.......................................................................53
Figure 3-4. Project Boundaries.............................................................................................................54
Figure 3-5. Project Data, Information and Report Flow.......................................................................59
Figure 3-6. 	Data Flow Diagram Legend................................................................................................60
Figure 4-1. Project Integration Management Overview.......................................................................65
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 4-2. 	Develop Project Charter: Inputs, Tools and Techniques, and Outputs..............................66
Figure 4-3. 	Develop Project Charter Data Flow Diagram.....................................................................67
Figure 4-3. 	Develop Project Charter Data Flow Diagram.....................................................................72
Figure 4-5. 	Develop Project Management Plan Data Flow Diagram...................................................73
Figure 4-6. 	Direct and Manage Project Work: Inputs, Tools and Techniques, and Outputs................79
Figure 4-7. 	Direct and Manage Project Work: Data Flow Diagram......................................................80
Figure 4-8. Monitor and Control Project Work: Inputs, Tools  Techniques, and Outputs..................86
Figure 4-9. Monitor and Control Project Work Data Flow Diagram.....................................................87
Figure 4-10. Perform Integrated Change Control: Inputs, Tools  Techniques, and Outputs...............94
Figure 4-11. Perform Integrated Change Control Data Flow Diagram..................................................95
Figure 4-12. 	Close Project or Phase: Inputs, Tools  Techniques, and Outputs..................................100
Figure 4-13. 	Close Project or Phase Data Flow Diagram.....................................................................101
Figure 5-1. Project Scope Management Overview.............................................................................106
Figure 5-2. Plan Scope Management: Inputs, Tools  Techniques, and Outputs..............................107
Figure 5-3. Plan Scope Management Data Flow Diagram.................................................................107
Figure 5-4. 	Collect Requirements: Inputs, Tools  Techniques, and Outputs...................................111
Figure 5-5. 	Collect Requirements Data Flow Diagram.......................................................................111
Figure 5-6. Example of a Requirements Traceability Matrix..............................................................119
Figure 5-7. 	Define Scope: Inputs, Tools  Techniques, and Outputs.................................................120
Figure 5-8. 	Define Scope Data Flow Diagram....................................................................................120
Figure 5-9. 	Create WBS: Inputs, Tools  Techniques, and Outputs...................................................125
Figure 5-10. 	Create WBS Data Flow Diagram.......................................................................................126
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XIII
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 5-11. Sample WBS Decomposed Down Through Work Packages............................................129
Figure 5-12. Sample WBS Organized by Phase....................................................................................130
Figure 5-13. Sample WBS with Major Deliverables..............................................................................130
Figure 5-14. Validate Scope: Inputs, Tools  Techniques, and Outputs..............................................133
Figure 5-15. Validate Scope Data Flow Diagram..................................................................................133
Figure 5-16. 	Control Scope: Inputs, Tools  Techniques, and Outputs................................................136
Figure 5-17. 	Control Scope Data Flow Diagram...................................................................................137
Figure 6-1. Project Time Management Overview...............................................................................143
Figure 6-2. Scheduling Overview........................................................................................................144
Figure 6-3. Plan Schedule Management: Inputs, Tools  Techniques, and Outputs.........................145
Figure 6-4. Plan Schedule Management Data Flow Diagram............................................................145
Figure 6-5. 	Define Activities: Inputs, Tools  Techniques, and Outputs............................................149
Figure 6-6. 	Define Activities Data Flow Diagram...............................................................................150
Figure 6-7. Sequence Activities: Inputs, Tools  Techniques, and Outputs......................................153
Figure 6-8. Sequence Activities Data Flow Diagram..........................................................................154
Figure 6-9. Precedence Diagramming Method (PDM) Relationship Types.......................................157
Figure 6-10. Examples of Lead and Lag...............................................................................................158
Figure 6-11. Project Schedule Network Diagram.................................................................................160
Figure 6-12. Estimate Activity Resources: Inputs, Tools  Techniques, and Outputs.........................161
Figure 6-13. Estimate Activity Resources Data Flow Diagram............................................................161
Figure 6-14. Estimate Activity Durations: Inputs, Tools  Techniques, and Outputs..........................166
Figure 6-15. Estimate Activity Durations Data Flow Diagram.............................................................166
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XIV ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 6-16 	Develop Schedule: Inputs, Tools  Techniques, and Outputs.........................................173
Figure 6-17. 	Develop Schedule Data Flow Diagram.............................................................................173
Figure 6-18. Example of Critical Path Method......................................................................................177
Figure 6-19. Example of Critical Chain Method....................................................................................178
Figure 6-20. 	Resource Leveling............................................................................................................179
Figure 6-21. Project Schedule Presentations —Examples..................................................................183
Figure 6-22. 	Control Schedule: Inputs, Tools  Techniques, and Outputs...........................................185
Figure 6-23. 	Control Schedule Data Flow Diagram..............................................................................186
Figure 7-1. Project Cost Management Overview................................................................................194
Figure 7-2. Plan Cost Management: Inputs, Tools  Techniques, and Outputs.................................195
Figure 7-3. Plan Cost Management: Data Flow Diagram...................................................................196
Figure 7-4. Estimate Costs: Inputs, Tools  Techniques, and Outputs..............................................200
Figure 7-5. Estimate Costs Data Flow Diagram.................................................................................201
Figure 7-6. 	Determine Budget: Inputs, Tools  Techniques, and Outputs.........................................208
Figure 7-7. 	Determine Budget Data Flow Diagram............................................................................209
Figure 7-8. Project Budget Components.............................................................................................213
Figure 7-9. 	Cost Baseline, Expenditures, and Funding Requirements..............................................214
Figure 7-10. 	Control Costs: Inputs, Tools  Techniques, and Outputs.................................................215
Figure 7-11. 	Control Costs Data Flow Diagram....................................................................................215
Figure 7-12. Earned Value, Planned Value, and Actual Costs..............................................................219
Figure 7-13. 	To-Complete Performance Index (TCPI)...........................................................................222
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XV
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 8-1. Project Quality Management Overview............................................................................230
Figure 8-2.
Fundamental Relationships of Quality Assurance and Control Quality to the IPECC,
PDCA, Cost of Quality Models and Project Management Process Groups.....................231
Figure 8-3. Plan Quality Management Inputs, Tools  Techniques, and Outputs.............................232
Figure 8-4. Plan Quality Management Data Flow Diagram................................................................232
Figure 8-5. 	Cost of Quality...................................................................................................................235
Figure 8-6. 	The SIPOC Model...............................................................................................................237
Figure 8-7.
Storyboard Illustrating a Conceptual Example of Each of the Seven
Basic Quality Tools...........................................................................................................239
Figure 8-8. Perform Quality Assurance: Inputs, Tools  Techniques, and Outputs...........................243
Figure 8-9. Perform Quality Assurance Data Flow Diagram..............................................................243
Figure 8-10. Storyboard Illustrating the Seven Quality Management and Control Tools...................246
Figure 8-11. 	Control Quality: Inputs, Tools  Techniques, and Outputs..............................................249
Figure 8-12. 	Control Quality Data Flow Diagram..................................................................................249
Figure 9-1. Project Human Resource Management Overview...........................................................257
Figure 9-2. Plan Human Resource Management: Inputs, Tools  Techniques, and Outputs............258
Figure 9-3. Plan Human Resource Management Data Flow Diagram...............................................258
Figure 9-4. 	Roles and Responsibility Definition Formats...................................................................261
Figure 9-5. 	RACI Matrix.......................................................................................................................262
Figure 9-6. Illustrative Resource Histogram......................................................................................266
Figure 9-7. Acquire Project Team: Inputs, Tools  Techniques, and Outputs....................................267
Figure 9-8. Acquire Project Team Data Flow Diagram.......................................................................268
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XVI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 9-9. 	Develop Project Team: Inputs, Tools  Techniques, and Outputs...................................273
Figure 9-10. 	Develop Project Team Data Flow Diagram......................................................................273
Figure 9-11. Manage Project Team: Inputs, Tools  Techniques, and Outputs...................................279
Figure 9-12. Manage Project Team Data Flow Diagram......................................................................280
Figure 10-1. Project Communications Management Overview...........................................................288
Figure 10-2. Plan Communications Management: Inputs, Tools  Techniques, and Outputs............289
Figure 10-3. Plan Communications Management Data Flow Diagram...............................................289
Figure 10-4. Basic Communication Model...........................................................................................294
Figure 10-5. Manage Communications: Inputs, Tools  Techniques, and Outputs.............................297
Figure 10-6. Manage Communications Data Flow Diagram................................................................298
Figure 10-7. 	Control Communications: Inputs, Tools  Techniques, and Outputs..............................303
Figure 10-8. 	Control Communications Data Flow Diagram.................................................................304
Figure 11-1. Project Risk Management Overview................................................................................312
Figure 11-2. Plan Risk Management: Inputs, Tools  Techniques, and Outputs.................................313
Figure 11-3. Plan Risk Management Data Flow Diagram....................................................................313
Figure 11-4. Example of a Risk Breakdown Structure (RBS)..............................................................317
Figure 11-5. Identify Risks: Inputs, Tools  Techniques, and Outputs................................................319
Figure 11-6. Identify Risks Data Flow Diagram...................................................................................320
Figure 11-7. Influence Diagram............................................................................................................326
Figure 11-8. Perform Qualitative Risk Analysis: Inputs, Tools  Techniques, and Outputs................328
Figure 11-9. Perform Qualitative Risk Analysis Data Flow Diagram...................................................328
Figure 11-10. Probability and Impact Matrix.........................................................................................331
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XVII
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 11-11. Perform Quantitative Risk Analysis: Inputs, Tools  Techniques, and Outputs.............334
Figure 11-12. Perform Quantitative Risk Analysis Data Flow Diagram.................................................334
Figure 11-13. Range of Project Cost Estimates Collected During the Risk Interview.........................336
Figure 11-14. Examples of Commonly Used Probability Distributions..................................................337
Figure 11-15. Example of Tornado Diagram...........................................................................................338
Figure 11-16. 	Decision Tree Diagram.....................................................................................................339
Figure 11-17. 	Cost Risk Simulation Results...........................................................................................340
Figure 11-18. Plan Risk Responses: Inputs, Tools  Techniques, and Outputs....................................342
Figure 11-19. Plan Risk Responses Data Flow Diagram........................................................................342
Figure 11-20. 	Control Risks: Inputs, Tools  Techniques, and Outputs.................................................349
Figure 11-21. 	Control Risks Data Flow Diagram....................................................................................349
Figure 12-1. Project Procurement Management Overview..................................................................356
Figure 12-2. Plan Procurements: Inputs, Tools  Techniques, and Outputs.......................................358
Figure 12-3. Plan Procurement Management Data Flow Diagram......................................................359
Figure 12-4. 	Conduct Procurements: Inputs, Tools  Techniques, and Outputs.................................371
Figure 12-5. 	Conduct Procurements Data Flow Diagram....................................................................372
Figure 12-6. 	Control Procurements: Inputs, Tools  Techniques, and Outputs...................................379
Figure 12-7. 	Control Procurements Data Flow Diagram......................................................................380
Figure 12-8. 	Close Procurements: Inputs, Tools  Techniques, and Outputs......................................386
Figure 12-9. 	Close Procurements Data Flow Diagram.........................................................................387
Figure 13-1. Project Stakeholder Management Overview...................................................................392
Figure 13-2. Identify Stakeholders: Inputs, Tools  Techniques, and Outputs....................................393
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XVIII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure 13-3. Identify Stakeholders Data Flow Diagram.......................................................................393
Figure 13-4. Example Power/Interest Grid with Stakeholders............................................................397
Figure 13-5. Plan Stakeholder Management: Inputs, Tools  Techniques, and Outputs....................399
Figure 13-6. Plan Stakeholder Management Data Flow Diagram.......................................................399
Figure 13-7. Stakeholders Engagement Assessment Matrix...............................................................403
Figure 13-8. Manage Stakeholder Engagement: Inputs, Tools  Techniques, and Outputs...............404
Figure 13-9. Manage Stakeholder Engagement Data Flow Diagram..................................................405
Figure 13-10. 	Control Stakeholder Engagement: Inputs, Tools  Techniques, and Outputs................410
Figure 13-11. 	Control Stakeholder Engagement: Data Flow Diagram...................................................410
Figure A1-1. Process Group Interactions in a Project..........................................................................419
Figure A1-2. Project Management Process Interactions.....................................................................421
Figure A1-3. Project Boundaries...........................................................................................................425
Figure A1-4. Initiating Process Group...................................................................................................425
Figure A1-5. 	Develop Project Charter: Inputs and Outputs..................................................................426
Figure A1-6. Identify Stakeholders: Inputs and Outputs......................................................................426
Figure A1-7. Planning Process Group...................................................................................................428
Figure A1-8. 	Develop Project Management Plan: Inputs and Outputs................................................429
Figure A1-9. Plan Scope Management: Inputs and Outputs................................................................429
Figure A1-10. 	Collect Requirements: Inputs and Outputs......................................................................430
Figure A1-11. 	Define Scope: Inputs and Outputs...................................................................................430
Figure A1-12. 	Create WBS: Inputs and Outputs......................................................................................431
Figure A1-13. Plan Schedule Management: Inputs and Outputs...........................................................431
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XIX
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure A1-14. 	Define Activities: Inputs and Outputs..............................................................................432
Figure A1-15. Sequence Activities: Inputs and Outputs.........................................................................432
Figure A1-16. Estimate Activity Resources: Inputs and Outputs...........................................................433
Figure A1-17. Estimate Activity Durations: Inputs and Outputs............................................................434
Figure A1-18. 	Develop Schedule: Inputs and Outputs............................................................................435
Figure A1-19. Plan Cost Management: Inputs and Outputs...................................................................436
Figure A1-20. Estimate Costs: Inputs and Outputs.................................................................................436
Figure A1-21. 	Determine Budget: Inputs and Outputs...........................................................................437
Figure A1-22. Plan Quality Management: Inputs and Outputs...............................................................438
Figure A1-23. Plan Human Resource Management: Inputs and Outputs..............................................438
Figure A1-24. Plan Communications Management: Inputs and Outputs..............................................439
Figure A1-25. Plan Risk Management: Inputs and Outputs...................................................................439
Figure A1-26. Identify Risks: Inputs and Outputs...................................................................................440
Figure A1-27. Perform Qualitative Risk Analysis: Inputs and Outputs..................................................441
Figure A1-28. Perform Quantitative Risk Analysis: Inputs and Outputs................................................441
Figure A1-29. Plan Risk Responses: Inputs and Outputs.......................................................................442
Figure A1-30. Plan Procurement Management: Inputs and Outputs.....................................................443
Figure A1-31. Plan Stakeholder Management: Inputs and Outputs......................................................443
Figure A1-32. Executing Process Group.................................................................................................445
Figure A1-33. 	Direct and Manage Project Work: Inputs and Outputs....................................................446
Figure A1-34. Perform Quality Assurance: Inputs and Outputs.............................................................446
Figure A1-35. Acquire Project Team: Inputs and Outputs......................................................................447
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XX ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure A1-36. 	Develop Project Team: Inputs and Outputs......................................................................447
Figure A1-37. Manage Project Team: Inputs and Outputs......................................................................448
Figure A1-38. Manage Communications: Inputs and Outputs...............................................................448
Figure A1-39. 	Conduct Procurements: Inputs and Outputs...................................................................449
Figure A1-40. Manage Stakeholder Engagement: Inputs and Outputs.................................................450
Figure A1-41. Monitoring and Controlling Process Group.....................................................................451
Figure A1-42. Monitor and Control Project Work: Inputs and Outputs..................................................452
Figure A1-43. Perform Integrated Change Control: Inputs and Outputs................................................453
Figure A1-44. Validate Scope: Inputs and Outputs.................................................................................453
Figure A1-45. 	Control Scope: Inputs and Outputs..................................................................................454
Figure A1-46. 	Control Schedule: Inputs and Outputs.............................................................................455
Figure A1-47. 	Control Costs: Inputs and Outputs...................................................................................455
Figure A1-48. 	Control Quality: Inputs and Outputs.................................................................................456
Figure A1-49. 	Control Communications: Inputs and Outputs................................................................457
Figure A1-50. 	Control Risks: Inputs and Outputs...................................................................................457
Figure A1-51. 	Control Procurements: Inputs and Outputs.....................................................................458
Figure A1-52. 	Control Stakeholder Engagement: Inputs and Outputs...................................................459
Figure A1-53. 	Closing Process Group.....................................................................................................460
Figure A1-54. 	Close Project or Phase: Inputs and Outputs....................................................................461
Figure A1-55. 	Close Procurements: Inputs and Outputs........................................................................461
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
XXI
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
List of TABLES and Figures
Figure X1-1. 	Refined Data Model..........................................................................................................467
Table 1-1. 	Comparative Overview of Project, Program, and Portfolio Management...........................8
Table 2-1. Influence of Organizational Structures on Projects..........................................................22
Table 3-1. Project Management Process Group and Knowledge Area Mapping...............................61
Table 4-1 	Differentiation Between the Project Management Plan and Project Documents............78
Table 5-1. Elements of the Project Charter and Project Scope Statement......................................124
Table 7-1. Earned Value Calculations Summary Table.....................................................................224
Table 11-1. 	Definition of Impact Scales for Four Project Objectives.................................................318
Table A1-1. Project Management Process Group and Knowledge Area Mapping.............................423
Table X1-1. Section 4 Changes............................................................................................................472
Table X1-2. Section 5 Changes............................................................................................................473
Table X1-3. Section 6 Changes............................................................................................................474
Table X1-4. Section 7 Changes............................................................................................................475
Table X1-5. Section 8 Changes............................................................................................................476
Table X1-6. Section 9 Changes............................................................................................................477
Table X1-7. Section 10 Changes..........................................................................................................478
Table X1-8. Section 11 Changes..........................................................................................................479
Table X1-9. Section 12 Changes..........................................................................................................480
Table X1-10. Section 13 Changes..........................................................................................................481
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
1
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
Introduction
A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition provides guidelines
for managing individual projects and defines project management related concepts. It also describes the project
management life cycle and its related processes, as well as the project life cycle.
The PMBOK®
Guide contains the globally recognized standard and guide for the project management profession
(found in Annex A1). A standard is a formal document that describes established norms, methods, processes, and
practices. As with other professions, the knowledge contained in this standard has evolved from the recognized
good practices of project management practitioners who have contributed to the development of this standard.
The first two sections of the PMBOK®
Guide provide an introduction to key concepts in the project management
field. Section 3 summarizes the Process Groups and provides an overview of process interactions among the ten
Knowledge Areas and five Process Groups. Sections 4 through 13 are the guide to the project management body of
knowledge.These sections expand on the information in the standard by describing the inputs and outputs, as well
as tools and techniques used in managing projects.Annex A1 is the standard for project management and presents
the processes, inputs, and outputs that are considered to be good practice on most projects most of the time.
This section defines several key terms and the relationship among portfolio management,program management,
project management and organizational project management. An overview of the PMBOK®
Guide is found within
the following sections:
1.1 Purpose of the PMBOK®
Guide
1.2 What is a Project?
1.3 What is Project Management?
1.4 Relationships Among Portfolio Management, Program Management,
Project Management,and Organizational Project Management
1.5 Relationship Between Project Management, Operations Management,
and Organizational Strategy
1.6 Business Value
1.7 Role of the Project Manager
1.8 Project Management Body of Knowledge
1
1
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
2 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
1.1 Purpose of the PMBOK®
Guide
The acceptance of project management as a profession indicates that the application of knowledge, processes,
skills, tools, and techniques can have a significant impact on project success. The PMBOK®
Guide identifies that
subset of the project management body of knowledge that is generally recognized as good practice. “Generally
recognized” means the knowledge and practices described are applicable to most projects most of the time, and
there is consensus about their value and usefulness. “Good practice” means there is general agreement that the
application of the knowledge, skills, tools, and techniques can enhance the chances of success over many projects.
“Good practice” does not mean that the knowledge described should always be applied uniformly to all projects; the
organization and/or project management team is responsible for determining what is appropriate for any given project.
The PMBOK®
Guide also provides and promotes a common vocabulary within the project management
profession for using and applying project management concepts. A common vocabulary is an essential element of
a professional discipline.The PMI Lexicon of Project Management Terms [1]1
provides the foundational professional
vocabulary that can be consistently used by project, program, and portfolio managers and other stakeholders.
Annex A1 is a foundational reference for PMI’s project management professional development programs. Annex
A1 continues to evolve along with the profession, and is therefore not all-inclusive; this standard is a guide rather
than a specific methodology. One can use different methodologies and tools (e.g., agile, waterfall, PRINCE2) to
implement the project management framework.
In addition to the standards that establish guidelines for project management processes,the Project Management
Institute Code of Ethics and Professional Conduct [2] guides practitioners of the profession and describes the
expectations that practitioners should hold for themselves and others. The Project Management Institute Code
of Ethics and Professional Conduct is specific about the basic obligation of responsibility, respect, fairness, and
honesty. It requires that practitioners demonstrate a commitment to ethical and professional conduct. It carries
the obligation to comply with laws, regulations, and organizational and professional policies. Practitioners come
from diverse backgrounds and cultures, and the Project Management Institute Code of Ethics and Professional
Conduct applies globally. When interacting with any stakeholder, practitioners should be committed to honest,
responsible, fair practices and respectful dealings.Acceptance of the code is essential for project managers, and is
a requirement for the following PMI®
exams:
• Certified Associate in Project Management (CAPM)®
• Project Management Professional (PMP)®
• Program Management Professional (PgMP)®
• PMI Agile Certified Practitioner (PMI-ACP)SM
• PMI Risk Management Professional (PMI-RMP)®
• PMI Scheduling Professional (PMI-SP)®
1
The numbers in brackets refer to the list of references at the end of this standard.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
3
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
1.2 What is a Project?
A project is a temporary endeavor undertaken to create a unique product, service, or result. The temporary
nature of projects indicates that a project has a definite beginning and end. The end is reached when the project’s
objectives have been achieved or when the project is terminated because its objectives will not or cannot be met,
or when the need for the project no longer exists. A project may also be terminated if the client (customer, sponsor,
or champion) wishes to terminate the project. Temporary does not necessarily mean the duration of the project
is short. It refers to the project’s engagement and its longevity. Temporary does not typically apply to the product,
service, or result created by the project; most projects are undertaken to create a lasting outcome. For example, a
project to build a national monument will create a result expected to last for centuries. Projects can also have social,
economic, and environmental impacts that far outlive the projects themselves.
Every project creates a unique product, service, or result. The outcome of the project may be tangible or
intangible. Although repetitive elements may be present in some project deliverables and activities, this repetition
does not change the fundamental, unique characteristics of the project work. For example, office buildings can
be constructed with the same or similar materials and by the same or different teams. However, each building
project remains unique with a different location, different design, different circumstances and situations, different
stakeholders, and so on.
An ongoing work effort is generally a repetitive process that follows an organization’s existing procedures.
In contrast, because of the unique nature of projects, there may be uncertainties or differences in the products,
services, or results that the project creates. Project activities can be new to members of a project team, which
may necessitate more dedicated planning than other routine work. In addition, projects are undertaken at all
organizational levels.A project can involve a single individual or multiple individuals, a single organizational unit, or
multiple organizational units from multiple organizations.
A project can create:
•
A product that can be either a component of another item, an enhancement of an item, or an end item
in itself;
•
A service or a capability to perform a service (e.g., a business function that supports production or
distribution);
•
An improvement in the existing product or service lines (e.g., A Six Sigma project undertaken to reduce
defects); or
•
A result, such as an outcome or document (e.g., a research project that develops knowledge that can be
used to determine whether a trend exists or a new process will benefit society).
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
4 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
Examples of projects include, but are not limited to:
•
Developing a new product, service, or result;
• Effecting a change in the structure, processes, staffing, or style of an organization;
• Developing or acquiring a new or modified information system (hardware or software);
• Conducting a research effort whose outcome will be aptly recorded;
• Constructing a building, industrial plant, or infrastructure; or
• Implementing, improving, or enhancing existing business processes and procedures.
1.2.1. The Relationships Among Portfolios, Programs, and Projects
The relationship among portfolios, programs, and projects is such that a portfolio refers to a collection of projects,
programs, subportfolios, and operations managed as a group to achieve strategic objectives. Programs are grouped
within a portfolio and are comprised of subprograms, projects, or other work that are managed in a coordinated
fashion in support of the portfolio. Individual projects that are either within or outside of a program are still considered
part of a portfolio. Although the projects or programs within the portfolio may not necessarily be interdependent or
directly related, they are linked to the organization’s strategic plan by means of the organization’s portfolio.
As Figure 1-1 illustrates, organizational strategies and priorities are linked and have relationships between
portfolios and programs, and between programs and individual projects. Organizational planning impacts
the projects by means of project prioritization based on risk, funding, and other considerations relevant to the
organization’s strategic plan. Organizational planning can direct the management of resources, and support for the
component projects on the basis of risk categories, specific lines of business, or general types of projects, such as
infrastructure and process improvement.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
5
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
Projects
Portfolio
Subportfolios
Programs
Subprograms
Projects
Projects
Projects
• Strategies and priorities
• Progressive elaboration
• Governance
• Disposition on requested changes
• Impacts from changes in other
portfolios, programs, or projects
• Strategies and priorities
• Progressive elaboration
• Governance
• Disposition on requested changes
• Impacts from changes in other
portfolios, programs, or projects
• Strategies and priorities
• Progressive elaboration
• Governance
• Disposition on requested changes
• Impacts from changes in other
portfolios, programs, or projects
• Performance reports
• Change requests with
impact on other portfolios,
programs, or projects
• Performance reports
• Change requests with
impact on other portfolios,
programs, or projects
• Performance reports
• Change requests with
impact on other portfolios,
programs, or projects
Programs
Subprograms
Projects
Projects
Figure 1-1. Portfolio, Program, and Project Management Interactions
1.3 What is Project Management?
Project management is the application of knowledge, skills, tools, and techniques to project activities to meet the
project requirements. Project management is accomplished through the appropriate application and integration of
the 47 logically grouped project management processes, which are categorized into five Process Groups.These five
Process Groups are:
• Initiating,
• Planning,
• Executing,
• Monitoring and Controlling, and
• Closing.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
6 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
Managing a project typically includes, but is not limited to:
• Identifying requirements;
•
Addressing the various needs, concerns, and expectations of the stakeholders in planning and executing
the project;
•
Setting up, maintaining, and carrying out communications among stakeholders that are active, effective,
and collaborative in nature;
• Managing stakeholders towards meeting project requirements and creating project deliverables;
• Balancing the competing project constraints, which include, but are not limited to:
○
○ Scope,
○
○ Quality,
○
○ Schedule,
○
○ Budget,
○
○ Resources, and
○
○ Risks.
The specific project characteristics and circumstances can influence the constraints on which the project
management team needs to focus.
The relationship among these factors is such that if any one factor changes, at least one other factor is likely
to be affected. For example, if the schedule is shortened, often the budget needs to be increased to add additional
resources to complete the same amount of work in less time. If a budget increase is not possible, the scope or
targeted quality may be reduced to deliver the project’s end result in less time within the same budget amount.
Project stakeholders may have differing ideas as to which factors are the most important, creating an even greater
challenge. Changing the project requirements or objectives may create additional risks. The project team needs to
be able to assess the situation, balance the demands, and maintain proactive communication with stakeholders in
order to deliver a successful project.
Due to the potential for change, the development of the project management plan is an iterative activity and is
progressively elaborated throughout the project’s life cycle.Progressive elaboration involves continuously improving
and detailing a plan as more detailed and specific information and more accurate estimates become available.
Progressive elaboration allows a project management team to define work and manage it to a greater level of detail
as the project evolves.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
7
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
1.4 Relationships Among Portfolio Management, Program Management,
Project Management, and Organizational Project Management
In order to understand portfolio, program, and project management, it is important to recognize the similarities
and differences among these disciplines. It is also helpful to understand how they relate to organizational project
management (OPM). OPM is a strategy execution framework utilizing project, program, and portfolio management
as well as organizational enabling practices to consistently and predictably deliver organizational strategy producing
better performance, better results, and a sustainable competitive advantage.
Portfolio, program, and project management are aligned with or driven by organizational strategies. Conversely,
portfolio,program,and project management differ in the way each contributes to the achievement of strategic goals.
Portfolio management aligns with organizational strategies by selecting the right programs or projects, prioritizing
the work,and providing the needed resources,whereas program management harmonizes its projects and program
components and controls interdependencies in order to realize specified benefits. Project management develops
and implements plans to achieve a specific scope that is driven by the objectives of the program or portfolio it is
subjected to and, ultimately, to organizational strategies. OPM advances organizational capability by linking project,
program, and portfolio management principles and practices with organizational enablers (e.g. structural, cultural,
technological, and human resource practices) to support strategic goals. An organization measures its capabilities,
then plans and implements improvements towards the systematic achievement of best practices.
Table 1-1 shows the comparison of project, program, and portfolio views across several dimensions within
the organization.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
8 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
Table 1-1. Comparative Overview of Project, Program, and Portfolio Management
Organizational Project Management
Projects Programs Portfolios
Projects have defined
objectives. Scope is progres-
sively elaborated throughout the
project life cycle.
Project managers expect change
and implement processes to
keep change managed and
controlled.
Project managers progressively
elaborate high-level information
into detailed plans throughout
the project life cycle.
Project managers manage the
project team to meet the project
objectives.
Success is measured by product
and project quality, timeliness,
budget compliance, and degree
of customer satisfaction.
Project managers monitor and
control the work of producing
the products, services, or results
that the project was undertaken
to produce.
Programs have a larger scope
and provide more significant
benefits.
Program managers expect
change from both inside and
outside the program and are
prepared to manage it.
Program managers develop the
overall program plan and create
high-level plans to guide
detailed planning at the
component level.
Program managers manage the
program staff and the project
managers; they provide vision
and overall leadership.
Success is measured by the
degree to which the program
satisfies the needs and benefits
for which it was undertaken.
Program managers monitor
the progress of program
components to ensure the
overall goals, schedules, budget,
and benefits of the program will
be met.
Portfolios have an organizational
scope that changes with the
strategic objectives of the
organization.
Portfolio managers continuously
monitor changes in the
broader internal and external
environment.
Portfolio managers create and
maintain necessary processes
and communication relative to
the aggregate portfolio.
Portfolio managers may manage
or coordinate portfolio
management staff, or program
and project staff that may have
reporting responsibilities into
the aggregate portfolio.
Success is measured in terms
of the aggregate investment
performance and benefit
realization of the portfolio.
Portfolio managers monitor
strategic changes and aggregate
resource allocation,
performance results, and risk
of the portfolio.
Scope
Change
Planning
Management
Success
Monitoring
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
9
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
1.4.1 Program Management
A program is defined as a group of related projects, subprograms, and program activities managed in a
coordinated way to obtain benefits not available from managing them individually. Programs may include elements
of related work outside the scope of the discrete projects in the program. A project may or may not be part of a
program but a program will always have projects.
Program management is the application of knowledge, skills, tools, and techniques to a program in order to
meet the program requirements and to obtain benefits and control not available by managing projects individually.
Projects within a program are related through the common outcome or collective capability. If the relationship
between projects is only that of a shared client, seller, technology, or resource, the effort should be managed as a
portfolio of projects rather than as a program.
Program management focuses on the project interdependencies and helps to determine the optimal approach
for managing them. Actions related to these interdependencies may include:
• Resolving resource constraints and/or conflicts that affect multiple projects within the program,
• Aligning organizational/strategic direction that affects project and program goals and objectives, and
• Resolving issues and change management within a shared governance structure.
An example of a program is a new communications satellite system with projects for design of the satellite and
the ground stations, the construction of each, the integration of the system, and the launch of the satellite.
1.4.2 Portfolio Management
A portfolio refers to projects, programs, subportfolios, and operations managed as a group to achieve strategic
objectives. The projects or programs of the portfolio may not necessarily be interdependent or directly related. For
example, an infrastructure firm that has the strategic objective of “maximizing the return on its investments” may
put together a portfolio that includes a mix of projects in oil and gas, power, water, roads, rail, and airports. From
this mix, the firm may choose to manage related projects as one program.All of the power projects may be grouped
together as a power program. Similarly, all of the water projects may be grouped together as a water program.
Thus, the power program and the water program become integral components of the enterprise portfolio of the
infrastructure firm.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
10 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
Portfolio management refers to the centralized management of one or more portfolios to achieve strategic
objectives. Portfolio management focuses on ensuring that projects and programs are reviewed to prioritize
resource allocation, and that the management of the portfolio is consistent with and aligned to organizational
strategies.
1.4.3 Projects and Strategic Planning
Projects are often utilized as a means of directly or indirectly achieving objectives within an organization’s
strategic plan. Projects are typically authorized as a result of one or more of the following strategic considerations:
•
Market demand (e.g., a car company authorizing a project to build more fuel-efficient cars in response
to gasoline shortages);
•
Strategic opportunity/business need (e.g., a training company authorizing a project to create a new
course to increase its revenues);
• Social need (e.g., a nongovernmental organization in a developing country authorizing a project to provide
potable water systems, latrines, and sanitation education to communities suffering from high rates of
infectious diseases);
•
Environmental consideration (e.g., a public company authorizing a project to create a new service for
electric car sharing to reduce pollution);
•
Customer request (e.g., an electric utility authorizing a project to build a new substation to serve a new
industrial park);
•
Technological advance (e.g., an electronics firm authorizing a new project to develop a faster, cheaper, and
smaller laptop based on advances in computer memory and electronics technology); and
•
Legal requirement (e.g., a chemical manufacturer authorizing a project to establish guidelines for proper
handling of a new toxic material).
1.4.4 Project Management Office
A project management office (PMO) is a management structure that standardizes the project-related governance
processes and facilitates the sharing of resources, methodologies, tools, and techniques. The responsibilities of a
PMO can range from providing project management support functions to actually being responsible for the direct
management of one or more projects.
There are several types of PMO structures in organizations, each varying in the degree of control and influence
they have on projects within the organization, such as:
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
11
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
• Supportive. Supportive PMOs provide a consultative role to projects by supplying templates, best
practices, training, access to information and lessons learned from other projects. This type of PMO
serves as a project repository. The degree of control provided by the PMO is low.
• Controlling. Controlling PMOs provide support and require compliance through various means.
Compliance may involve adopting project management frameworks or methodologies, using specific
templates, forms and tools, or conformance to governance. The degree of control provided by the PMO
is moderate.
• Directive. Directive PMOs take control of the projects by directly managing the projects. The degree of
control provided by the PMO is high.
The PMO integrates data and information from corporate strategic projects and evaluates how higher level
strategic objectives are being fulfilled. The PMO is the natural liaison between the organization’s portfolios,
programs, projects, and the corporate measurement systems (e.g. balanced scorecard).
The projects supported or administered by the PMO may not be related, other than by being managed together.
The specific form, function, and structure of a PMO are dependent upon the needs of the organization that it
supports.
A PMO may have the authority to act as an integral stakeholder and a key decision maker throughout the life
of each project, to make recommendations, or to terminate projects or take other actions, as required, to remain
aligned with the business objectives. In addition, the PMO may be involved in the selection, management, and
deployment of shared or dedicated project resources.
A primary function of a PMO is to support project managers in a variety of ways which may include, but are not
limited to:
• Managing shared resources across all projects administered by the PMO;
• Identifying and developing project management methodology, best practices, and standards;
• Coaching, mentoring, training, and oversight;
• Monitoring compliance with project management standards,policies,procedures,and templates by means
of project audits;
•
Developing and managing project policies, procedures, templates, and other shared documentation
(organizational process assets); and
• Coordinating communication across projects.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
12 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1 - INTRODUCTION
Project managers and PMOs pursue different objectives and, as such, are driven by different requirements. All
of these efforts are aligned with the strategic needs of the organization. Differences between the role of project
managers and a PMO may include the following:
•
The project manager focuses on the specified project objectives, while the PMO manages major program
scope changes, which may be seen as potential opportunities to better achieve business objectives.
•
The project manager controls the assigned project resources to best meet project objectives, while the
PMO optimizes the use of shared organizational resources across all projects.
•
The project manager manages the constraints (scope, schedule, cost, quality, etc.) of the individual
projects, while the PMO manages the methodologies, standards, overall risks/opportunities, metrics, and
interdependencies among projects at the enterprise level.
1.5 Relationship Between Project Management, Operations Management,
and Organizational Strategy
Operations management is responsible for overseeing,directing,and controlling business operations.Operations
evolve to support the day-to-day business,and are necessary to achieve strategic and tactical goals of the business.
Examples include: production operations, manufacturing operations, accounting operations, software support, and
maintenance.
Though temporary in nature, projects can help achieve the organizational goals when they are aligned with the
organization’s strategy.Organizations sometimes change their operations,products,or systems by creating strategic
business initiatives that are developed and implemented through projects. Projects require project management
activities and skill sets,while operations require business process management,operations management activities,
and skill sets.
1.5.1 Operations and Project Management
Changes in business operations may be the focus of a dedicated project—especially if there are substantial
changes to business operations as a result of a new product or service delivery. Ongoing operations are outside of
the scope of a project; however, there are intersecting points where the two areas cross.
Projects can intersect with operations at various points during the product life cycle, such as:
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
13
©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK®
Guide) – Fifth Edition
1
1 - INTRODUCTION
• At each closeout phase;
• When developing a new product, upgrading a product, or expanding outputs;
• While improving operations or the product development process; or
• Until the end of the product life cycle.
At each point,deliverables and knowledge are transferred between the project and operations for implementation
of the delivered work. This implementation occurs through a transfer of project resources to operations toward the
end of the project, or through a transfer of operational resources to the project at the start.
Operations are ongoing endeavors that produce repetitive outputs, with resources assigned to do basically the
same set of tasks according to the standards institutionalized in a product life cycle. Unlike the ongoing nature of
operations, projects are temporary endeavors.
1.5.1.1 Operations Management
Operations management is a subject area that is outside the scope of formal project management as described
in this standard.
Operations management is an area of management concerned with ongoing production of goods and/or
services. It involves ensuring that business operations continue efficiently by using the optimum resources needed
and meeting customer demands. It is concerned with managing processes that transform inputs (e.g., materials,
components, energy, and labor) into outputs (e.g., products, goods, and/or services).
1.5.1.2 Operational Stakeholders in Project Management
While operations management is different from project management (see 1.5.1.1), the needs of stakeholders
who perform and conduct business operations are important considerations in projects that will affect their future
work and endeavors. Project managers who consider and appropriately include operational stakeholders in all
phases of projects, gain insight and avoid unnecessary issues that often arise when their input is overlooked.
Operational stakeholders should be engaged and their needs identified as part of the stakeholder register, and
their influence (positive or negative) should be addressed as part of the risk management plan.
Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412
This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf

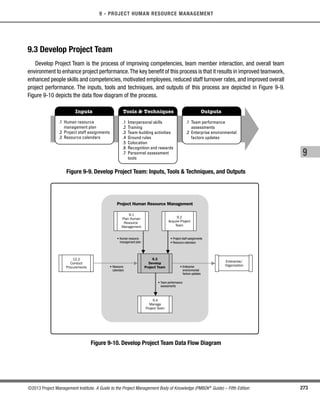

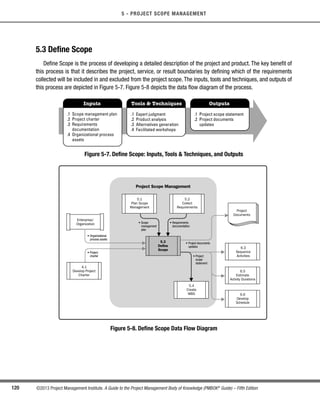

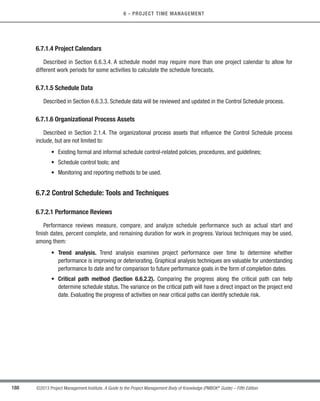

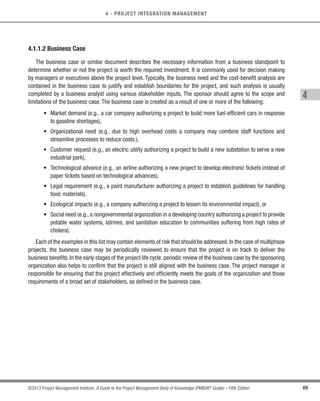

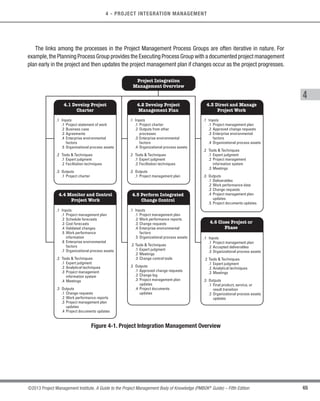

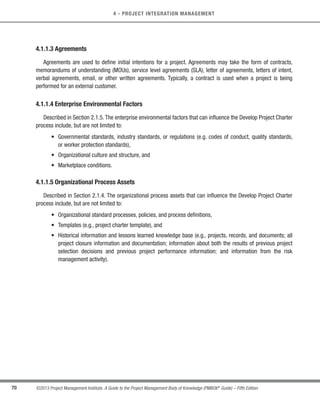

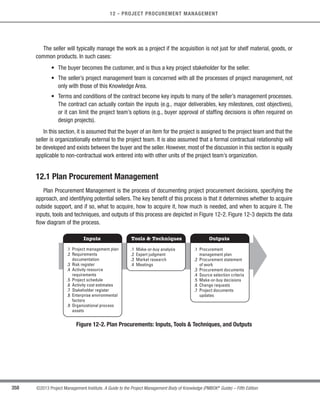

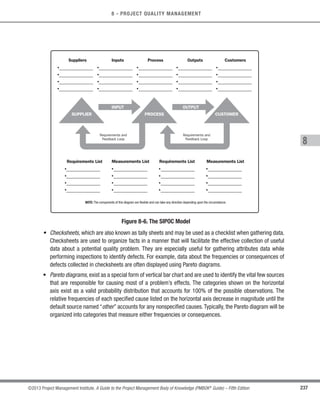

PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf
PMBOKGuide_5th_Ed.pdf

More Related Content

Similar to PMBOKGuide_5th_Ed.pdf

AGILE PRACTICE GUIDE
AGILE PRACTICE GUIDEAGILE PRACTICE GUIDE
AGILE PRACTICE GUIDEZaara Jensen

The Walt Disney Company – The Cohesion Case – is featured chapter .docx
The Walt Disney Company – The Cohesion Case – is featured chapter .docxThe Walt Disney Company – The Cohesion Case – is featured chapter .docx
The Walt Disney Company – The Cohesion Case – is featured chapter .docxchristalgrieg

Work Breakdown Structure PMI.pdf
Work Breakdown Structure PMI.pdfWork Breakdown Structure PMI.pdf
Work Breakdown Structure PMI.pdfmendezm22

Project management professional exam outline
Project management professional exam outlineProject management professional exam outline
Project management professional exam outlineDadunoor Kamati

Project management professional handbook
Project management professional handbookProject management professional handbook
Project management professional handbookDadunoor Kamati

Insights and Trends: Current Portfolio, Programme, and Project Management ...
Insights and Trends:  Current Portfolio,  Programme, and Project  Management ...Insights and Trends:  Current Portfolio,  Programme, and Project  Management ...
Insights and Trends: Current Portfolio, Programme, and Project Management ...CollectiveKnowledge

How can you use the Training and Education function model mentio.docx
How can you use the Training and Education function model mentio.docxHow can you use the Training and Education function model mentio.docx
How can you use the Training and Education function model mentio.docxpooleavelina

Project Management Methodology_rFmAt0BhU0dwihA.pdf
Project Management Methodology_rFmAt0BhU0dwihA.pdfProject Management Methodology_rFmAt0BhU0dwihA.pdf
Project Management Methodology_rFmAt0BhU0dwihA.pdfFaisalAziz831398

Certified associate project_management_handbook
Certified associate project_management_handbookCertified associate project_management_handbook
Certified associate project_management_handbookIván Saavedra Maufras

Guid to implement initiating and planning processes
Guid to implement initiating and planning processesGuid to implement initiating and planning processes
Guid to implement initiating and planning processesmohamed fawzy

Capm Free Seminar Presentation
Capm Free Seminar PresentationCapm Free Seminar Presentation
Capm Free Seminar PresentationRavindra Kamthe

Risk management professional handbook
Risk management professional handbookRisk management professional handbook
Risk management professional handbookSugianto Muljono

The Total Economic Impact of Using ThoughtWorks' Agile Development Approach
The Total Economic Impact of Using ThoughtWorks' Agile Development ApproachThe Total Economic Impact of Using ThoughtWorks' Agile Development Approach
The Total Economic Impact of Using ThoughtWorks' Agile Development ApproachThoughtworks

Product Manager or Product Owner
Product Manager or Product OwnerProduct Manager or Product Owner
Product Manager or Product OwnerDhiren Jani

Similar to PMBOKGuide_5th_Ed.pdf (20)

AGILE PRACTICE GUIDE
AGILE PRACTICE GUIDEAGILE PRACTICE GUIDE
AGILE PRACTICE GUIDE

The Walt Disney Company – The Cohesion Case – is featured chapter .docx
The Walt Disney Company – The Cohesion Case – is featured chapter .docxThe Walt Disney Company – The Cohesion Case – is featured chapter .docx
The Walt Disney Company – The Cohesion Case – is featured chapter .docx

Work Breakdown Structure PMI.pdf
Work Breakdown Structure PMI.pdfWork Breakdown Structure PMI.pdf
Work Breakdown Structure PMI.pdf

Project management professional exam outline
Project management professional exam outlineProject management professional exam outline
Project management professional exam outline

Pmp
PmpPmp
Pmp

PMI Indonesia Chapter Profile
PMI Indonesia Chapter ProfilePMI Indonesia Chapter Profile
PMI Indonesia Chapter Profile

Pmp handbook
Pmp handbookPmp handbook
Pmp handbook

Project management professional handbook
Project management professional handbookProject management professional handbook
Project management professional handbook

Insights and Trends: Current Portfolio, Programme, and Project Management ...
Insights and Trends:  Current Portfolio,  Programme, and Project  Management ...Insights and Trends:  Current Portfolio,  Programme, and Project  Management ...
Insights and Trends: Current Portfolio, Programme, and Project Management ...

How can you use the Training and Education function model mentio.docx
How can you use the Training and Education function model mentio.docxHow can you use the Training and Education function model mentio.docx
How can you use the Training and Education function model mentio.docx

Project Management Methodology_rFmAt0BhU0dwihA.pdf
Project Management Methodology_rFmAt0BhU0dwihA.pdfProject Management Methodology_rFmAt0BhU0dwihA.pdf
Project Management Methodology_rFmAt0BhU0dwihA.pdf

3aug-ConferenceProceedings-final
3aug-ConferenceProceedings-final3aug-ConferenceProceedings-final
3aug-ConferenceProceedings-final

Certified associate project_management_handbook
Certified associate project_management_handbookCertified associate project_management_handbook
Certified associate project_management_handbook

Guid to implement initiating and planning processes
Guid to implement initiating and planning processesGuid to implement initiating and planning processes
Guid to implement initiating and planning processes

Capm Free Seminar Presentation
Capm Free Seminar PresentationCapm Free Seminar Presentation
Capm Free Seminar Presentation

B190p sample
B190p sampleB190p sample
B190p sample

ISO_5
ISO_5ISO_5
ISO_5

Risk management professional handbook
Risk management professional handbookRisk management professional handbook
Risk management professional handbook

The Total Economic Impact of Using ThoughtWorks' Agile Development Approach
The Total Economic Impact of Using ThoughtWorks' Agile Development ApproachThe Total Economic Impact of Using ThoughtWorks' Agile Development Approach
The Total Economic Impact of Using ThoughtWorks' Agile Development Approach

Product Manager or Product Owner
Product Manager or Product OwnerProduct Manager or Product Owner
Product Manager or Product Owner

Recently uploaded

UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdf
UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdfUGC NET Paper 1 Mathematical Reasoning & Aptitude.pdf
UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdfNirmal Dwivedi

ICT Role in 21st Century Education & its Challenges.pptx
ICT Role in 21st Century Education & its Challenges.pptxICT Role in 21st Century Education & its Challenges.pptx
ICT Role in 21st Century Education & its Challenges.pptxAreebaZafar22

Kodo Millet PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...
Kodo Millet  PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...Kodo Millet  PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...
Kodo Millet PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...pradhanghanshyam7136

Activity 01 - Artificial Culture (1).pdf
Activity 01 - Artificial Culture (1).pdfActivity 01 - Artificial Culture (1).pdf
Activity 01 - Artificial Culture (1).pdfciinovamais

Understanding Accommodations and Modifications
Understanding  Accommodations and ModificationsUnderstanding  Accommodations and Modifications
Understanding Accommodations and ModificationsMJDuyan

Unit-V; Pricing (Pharma Marketing Management).pptx
Unit-V; Pricing (Pharma Marketing Management).pptxUnit-V; Pricing (Pharma Marketing Management).pptx
Unit-V; Pricing (Pharma Marketing Management).pptxVishalSingh1417

Spellings Wk 3 English CAPS CARES Please Practise
Spellings Wk 3 English CAPS CARES Please PractiseSpellings Wk 3 English CAPS CARES Please Practise
Spellings Wk 3 English CAPS CARES Please PractiseAnaAcapella

Making communications land - Are they received and understood as intended? we...
Making communications land - Are they received and understood as intended? we...Making communications land - Are they received and understood as intended? we...
Making communications land - Are they received and understood as intended? we...Association for Project Management

SOC 101 Demonstration of Learning Presentation
SOC 101 Demonstration of Learning PresentationSOC 101 Demonstration of Learning Presentation
SOC 101 Demonstration of Learning Presentationcamerronhm

How to Manage Global Discount in Odoo 17 POS
How to Manage Global Discount in Odoo 17 POSHow to Manage Global Discount in Odoo 17 POS
How to Manage Global Discount in Odoo 17 POSCeline George

Food safety_Challenges food safety laboratories_.pdf
Food safety_Challenges food safety laboratories_.pdfFood safety_Challenges food safety laboratories_.pdf
Food safety_Challenges food safety laboratories_.pdfSherif Taha

ICT role in 21st century education and it's challenges.
ICT role in 21st century education and it's challenges.ICT role in 21st century education and it's challenges.
ICT role in 21st century education and it's challenges.MaryamAhmad92

Mixin Classes in Odoo 17 How to Extend Models Using Mixin Classes
Mixin Classes in Odoo 17  How to Extend Models Using Mixin ClassesMixin Classes in Odoo 17  How to Extend Models Using Mixin Classes
Mixin Classes in Odoo 17 How to Extend Models Using Mixin ClassesCeline George

Grant Readiness 101 TechSoup and Remy Consulting
Grant Readiness 101 TechSoup and Remy ConsultingGrant Readiness 101 TechSoup and Remy Consulting
Grant Readiness 101 TechSoup and Remy ConsultingTechSoup

Seal of Good Local Governance (SGLG) 2024Final.pptx
Seal of Good Local Governance (SGLG) 2024Final.pptxSeal of Good Local Governance (SGLG) 2024Final.pptx
Seal of Good Local Governance (SGLG) 2024Final.pptxnegromaestrong

TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...
TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...
TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...Nguyen Thanh Tu Collection

Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...
Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...
Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...christianmathematics

psychiatric nursing HISTORY COLLECTION .docx
psychiatric  nursing HISTORY  COLLECTION  .docxpsychiatric  nursing HISTORY  COLLECTION  .docx
psychiatric nursing HISTORY COLLECTION .docxPoojaSen20

Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...
Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...
Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...ZurliaSoop

Recently uploaded (20)

UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdf
UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdfUGC NET Paper 1 Mathematical Reasoning & Aptitude.pdf
UGC NET Paper 1 Mathematical Reasoning & Aptitude.pdf

ICT Role in 21st Century Education & its Challenges.pptx
ICT Role in 21st Century Education & its Challenges.pptxICT Role in 21st Century Education & its Challenges.pptx
ICT Role in 21st Century Education & its Challenges.pptx

Kodo Millet PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...
Kodo Millet  PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...Kodo Millet  PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...
Kodo Millet PPT made by Ghanshyam bairwa college of Agriculture kumher bhara...

Activity 01 - Artificial Culture (1).pdf
Activity 01 - Artificial Culture (1).pdfActivity 01 - Artificial Culture (1).pdf
Activity 01 - Artificial Culture (1).pdf

Understanding Accommodations and Modifications
Understanding  Accommodations and ModificationsUnderstanding  Accommodations and Modifications
Understanding Accommodations and Modifications

Unit-V; Pricing (Pharma Marketing Management).pptx
Unit-V; Pricing (Pharma Marketing Management).pptxUnit-V; Pricing (Pharma Marketing Management).pptx
Unit-V; Pricing (Pharma Marketing Management).pptx

Spellings Wk 3 English CAPS CARES Please Practise
Spellings Wk 3 English CAPS CARES Please PractiseSpellings Wk 3 English CAPS CARES Please Practise
Spellings Wk 3 English CAPS CARES Please Practise

Making communications land - Are they received and understood as intended? we...
Making communications land - Are they received and understood as intended? we...Making communications land - Are they received and understood as intended? we...
Making communications land - Are they received and understood as intended? we...

SOC 101 Demonstration of Learning Presentation
SOC 101 Demonstration of Learning PresentationSOC 101 Demonstration of Learning Presentation
SOC 101 Demonstration of Learning Presentation

How to Manage Global Discount in Odoo 17 POS
How to Manage Global Discount in Odoo 17 POSHow to Manage Global Discount in Odoo 17 POS
How to Manage Global Discount in Odoo 17 POS

Food safety_Challenges food safety laboratories_.pdf
Food safety_Challenges food safety laboratories_.pdfFood safety_Challenges food safety laboratories_.pdf
Food safety_Challenges food safety laboratories_.pdf

ICT role in 21st century education and it's challenges.
ICT role in 21st century education and it's challenges.ICT role in 21st century education and it's challenges.
ICT role in 21st century education and it's challenges.

Mixin Classes in Odoo 17 How to Extend Models Using Mixin Classes
Mixin Classes in Odoo 17  How to Extend Models Using Mixin ClassesMixin Classes in Odoo 17  How to Extend Models Using Mixin Classes
Mixin Classes in Odoo 17 How to Extend Models Using Mixin Classes

Grant Readiness 101 TechSoup and Remy Consulting
Grant Readiness 101 TechSoup and Remy ConsultingGrant Readiness 101 TechSoup and Remy Consulting
Grant Readiness 101 TechSoup and Remy Consulting

Seal of Good Local Governance (SGLG) 2024Final.pptx
Seal of Good Local Governance (SGLG) 2024Final.pptxSeal of Good Local Governance (SGLG) 2024Final.pptx
Seal of Good Local Governance (SGLG) 2024Final.pptx

TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...
TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...
TỔNG ÔN TẬP THI VÀO LỚP 10 MÔN TIẾNG ANH NĂM HỌC 2023 - 2024 CÓ ĐÁP ÁN (NGỮ Â...

Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...
Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...
Explore beautiful and ugly buildings. Mathematics helps us create beautiful d...

psychiatric nursing HISTORY COLLECTION .docx
psychiatric  nursing HISTORY  COLLECTION  .docxpsychiatric  nursing HISTORY  COLLECTION  .docx
psychiatric nursing HISTORY COLLECTION .docx

Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...
Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...
Jual Obat Aborsi Hongkong ( Asli No.1 ) 085657271886 Obat Penggugur Kandungan...

Asian American Pacific Islander Month DDSD 2024.pptx
Asian American Pacific Islander Month DDSD 2024.pptxAsian American Pacific Islander Month DDSD 2024.pptx
Asian American Pacific Islander Month DDSD 2024.pptx

PMBOKGuide_5th_Ed.pdf

  • 1. Project Management Institute A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 2. ISBN: 978-1-935589-67-9 Published by: Project Management Institute, Inc. 14 Campus Boulevard Newtown Square, Pennsylvania 19073-3299 USA Phone: +610-356-4600 Fax: +610-356-4647 Email: customercare@pmi.org Internet: www.PMI.org ©2013 Project Management Institute, Inc. All rights reserved. “PMI”, the PMI logo, “PMP”, the PMP logo, “PMBOK”, “PgMP”, “Project Management Journal”, “PM Network”, and the PMI Today logo are registered marks of Project Management Institute, Inc. The Quarter Globe Design is a trademark of the Project Management Institute, Inc. For a comprehensive list of PMI marks, contact the PMI Legal Department. PMI Publications welcomes corrections and comments on its books. Please feel free to send comments on typographical, formatting, or other errors. Simply make a copy of the relevant page of the book, mark the error, and send it to: Book Editor, PMI Publications, 14 Campus Boulevard, Newtown Square, PA 19073-3299 USA. To inquire about discounts for resale or educational purposes, please contact the PMI Book Service Center. PMI Book Service Center P.O. Box 932683, Atlanta, GA 31193-2683 USA Phone: 1-866-276-4764 (within the U.S. or Canada) or +1-770-280-4129 (globally) Fax: +1-770-280-4113 Email: info@bookorders.pmi.org Printed in the United States of America. No part of this work may be reproduced or transmitted in any form or by any means, electronic, manual, photocopying, recording, or by any information storage and retrieval system, without prior written permission of the publisher. The paper used in this book complies with the Permanent Paper Standard issued by the National Information Standards Organization (Z39.48—1984). 10 9 8 7 6 5 4 3 2 1 Library of Congress Cataloging-in-Publication Data A guide to the project management body of knowledge (PMBOK® guide). -- Fifth edition. pages cm Includes bibliographical references and index. ISBN 978-1-935589-67-9 (pbk. : alk. paper) 1. Project management. I. Project Management Institute. II. Title: PMBOK guide. HD69.P75G845 2013 658.4’04--dc23 2012046112 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 3. Notice The Project Management Institute, Inc. (PMI) standards and guideline publications, of which the document contained herein is one,are developed through a voluntary consensus standards development process.This process brings together volunteers and/or seeks out the views of persons who have an interest in the topic covered by this publication. While PMI administers the process and establishes rules to promote fairness in the development of consensus, it does not write the document and it does not independently test, evaluate, or verify the accuracy or completeness of any information or the soundness of any judgments contained in its standards and guideline publications. PMI disclaims liability for any personal injury, property or other damages of any nature whatsoever, whether special, indirect, consequential or compensatory, directly or indirectly resulting from the publication, use of application, or reliance on this document. PMI disclaims and makes no guaranty or warranty, expressed or implied, as to the accuracy or completeness of any information published herein, and disclaims and makes no warranty that the information in this document will fulfill any of your particular purposes or needs. PMI does not undertake to guarantee the performance of any individual manufacturer or seller’s products or services by virtue of this standard or guide. In publishing and making this document available, PMI is not undertaking to render professional or other services for or on behalf of any person or entity, nor is PMI undertaking to perform any duty owed by any person or entity to someone else. Anyone using this document should rely on his or her own independent judgment or, as appropriate, seek the advice of a competent professional in determining the exercise of reasonable care in any given circumstances. Information and other standards on the topic covered by this publication may be available from other sources, which the user may wish to consult for additional views or information not covered by this publication. PMI has no power,nor does it undertake to police or enforce compliance with the contents of this document. PMI does not certify, test, or inspect products, designs, or installations for safety or health purposes. Any certification or other statement of compliance with any health or safety-related information in this document shall not be attributable to PMI and is solely the responsibility of the certifier or maker of the statement. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.

  • 4. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 5. I ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS Table of Contents 1. Introduction...................................................................................................................... 1 1.1 Purpose of the PMBOK® Guide................................................................................. 2 1.2 What is a Project?....................................................................................................... 3 1.2.1. The Relationships Among Portfolios, Programs, and Projects..................... 4 1.3 What is Project Management?.................................................................................... 5 1.4 Relationships Among Portfolio Management, Program Management, Project Management, and Organizational Project Management............................................ 7 1.4.1 Program Management.................................................................................... 9 1.4.2 Portfolio Management..................................................................................... 9 1.4.3 Projects and Strategic Planning................................................................... 10 1.4.4 Project Management Office.......................................................................... 10 1.5 Relationship Between Project Management, Operations Management, and Organizational Strategy............................................................................................. 12 1.5.1 Operations and Project Management........................................................... 12 1.5.2 Organizations and Project Management...................................................... 14 1.6 Business Value.......................................................................................................... 15 1.7 Role of the Project Manager...................................................................................... 16 1.7.1 Responsibilities and Competencies of the Project Manager....................... 17 1.7.2 Interpersonal Skills of a Project Manager.................................................... 17 1.8 Project Management Body of Knowledge................................................................ 18 2. ORGANIZATIONAL INFLUENCES AND PROJECT LIFE CYCLE............................................... 19 2.1 Organizational Influences on Project Management................................................. 20 2.1.1 Organizational Cultures and Styles.............................................................. 20 2.1.2 Organizational Communications.................................................................. 21 2.1.3 Organizational Structures............................................................................. 21 2.1.4 Organizational Process Assets..................................................................... 27 2.1.5 Enterprise Environmental Factors................................................................ 29 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 6. II ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 2.2 Project Stakeholders and Governance..................................................................... 30 2.2.1 Project Stakeholders..................................................................................... 30 2.2.2 Project Governance....................................................................................... 34 2.2.3 Project Success............................................................................................. 35 2.3 Project Team.............................................................................................................. 35 2.3.1 Composition of Project Teams...................................................................... 37 2.4 Project Life Cycle....................................................................................................... 38 2.4.1 Characteristics of the Project Life Cycle...................................................... 38 2.4.2 Project Phases............................................................................................... 41 3. PROJECT MANAGEMENT PROCESSES................................................................................ 47 3.1 Common Project Management Process Interactions............................................... 50 3.2 Project Management Process Groups...................................................................... 52 3.3 Initiating Process Group............................................................................................ 54 3.4 Planning Process Group............................................................................................ 55 3.5 Executing Process Group.......................................................................................... 56 3.6 Monitoring and Controlling Process Group.............................................................. 57 3.7 Closing Process Group.............................................................................................. 57 3.8 Project Information.................................................................................................... 58 3.9 Role of the Knowledge Areas.................................................................................... 60 4. PROJECT INTEGRATION MANAGEMENT.............................................................................. 63 4.1 Develop Project Charter............................................................................................ 66 4.1.1 Develop Project Charter: Inputs.................................................................... 68 4.1.2 Develop Project Charter: Tools and Techniques........................................... 71 4.1.3 Develop Project Charter: Outputs................................................................. 71 4.2 Develop Project Management Plan........................................................................... 72 4.2.1 Develop Project Management Plan: Inputs.................................................. 74 4.2.2 Develop Project Management Plan: Tools and Techniques......................... 76 4.2.3 Develop Project Management Plan: Outputs................................................ 76 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 7. III ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 4.3 Direct and Manage Project Work.............................................................................. 79 4.3.1 Direct and Manage Project Work: Inputs..................................................... 82 4.3.2 Direct and Manage Project Work: Tools and Techniques............................ 83 4.3.3 Direct and Manage Project Work: Outputs................................................... 84 4.4 Monitor and Control Project Work............................................................................ 86 4.4.1 Monitor and Control Project Work: Inputs.................................................... 88 4.4.2 Monitor and Control Project Work: Tools and Techniques........................... 91 4.4.3 Monitor and Control Project Work: Outputs................................................. 92 4.5 Perform Integrated Change Control.......................................................................... 94 4.5.1 Perform Integrated Change Control: Inputs................................................. 97 4.5.2 Perform Integrated Change Control: Tools and Techniques........................ 98 4.5.3 Perform Integrated Change Control: Outputs............................................... 99 4.6 Close Project or Phase............................................................................................ 100 4.6.1 Close Project or Phase: Inputs.................................................................... 102 4.6.2 Close Project or Phase: Tools and Techniques........................................... 102 4.6.3 Close Project or Phase: Outputs................................................................. 103 5. PROJECT SCOPE MANAGEMENT....................................................................................... 105 5.1 Plan Scope Management......................................................................................... 107 5.1.1 Plan Scope Management: Inputs................................................................ 108 5.1.2 Plan Scope Management: Tools and Techniques....................................... 109 5.1.3 Plan Scope Management: Outputs............................................................. 109 5.2 Collect Requirements.............................................................................................. 110 5.2.1 Collect Requirements: Inputs..................................................................... 113 5.2.2 Collect Requirements: Tools and Techniques............................................ 114 5.2.3 Collect Requirements: Outputs................................................................... 117 5.3 Define Scope............................................................................................................ 120 5.3.1 Define Scope: Inputs................................................................................... 121 5.3.2 Define Scope: Tools and Techniques.......................................................... 122 5.3.3 Define Scope: Outputs................................................................................. 123 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 8. IV ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 5.4 Create WBS.............................................................................................................. 125 5.4.1 Create WBS: Inputs..................................................................................... 127 5.4.2 Create WBS: Tools and Techniques............................................................ 128 5.4.3 Create WBS: Outputs................................................................................... 131 5.5 Validate Scope......................................................................................................... 133 5.5.1 Validate Scope: Inputs................................................................................ 134 5.5.2 Validate Scope: Tools and Techniques....................................................... 135 5.5.3 Validate Scope: Outputs.............................................................................. 135 5.6 Control Scope.......................................................................................................... 136 5.6.1 Control Scope: Inputs.................................................................................. 138 5.6.2 Control Scope: Tools and Techniques......................................................... 139 5.6.3 Control Scope: Outputs............................................................................... 139 6. PROJECT TIME MANAGEMENT.......................................................................................... 141 6.1 Plan Schedule Management.................................................................................. 145 6.1.1 Plan Schedule Management: Inputs........................................................... 146 6.1.2 Plan Schedule Management: Tools and Techniques.................................. 147 6.1.3 Plan Schedule Management: Outputs........................................................ 148 6.2 Define Activities....................................................................................................... 149 6.2.1 Define Activities: Inputs.............................................................................. 150 6.2.2 Define Activities: Tools and Techniques..................................................... 151 6.2.3 Define Activities: Outputs........................................................................... 152 6.3 Sequence Activities................................................................................................. 153 6.3.1 Sequence Activities: Inputs........................................................................ 154 6.3.2 Sequence Activities: Tools and Techniques............................................... 156 6.3.3 Sequence Activities: Outputs...................................................................... 159 6.4 Estimate Activity Resources................................................................................... 160 6.4.1 Estimate Activity Resources: Inputs........................................................... 162 6.4.2 Estimate Activity Resources: Tools and Techniques.................................. 164 6.4.3 Estimate Activity Resources: Outputs........................................................ 165 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 9. V ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 6.5 Estimate Activity Durations..................................................................................... 165 6.5.1 Estimate Activity Durations: Inputs............................................................ 167 6.5.2 Estimate Activity Durations: Tools and Techniques................................... 169 6.5.3 Estimate Activity Durations: Outputs......................................................... 172 6.6 Develop Schedule.................................................................................................... 172 6.6.1 Develop Schedule: Inputs........................................................................... 174 6.6.2 Develop Schedule: Tools and Techniques.................................................. 176 6.6.3 Develop Schedule: Outputs......................................................................... 181 6.7 Control Schedule..................................................................................................... 185 6.7.1 Control Schedule: Inputs............................................................................. 187 6.7.2 Control Schedule: Tools and Techniques.................................................... 188 6.7.3 Control Schedule: Outputs.......................................................................... 190 7. PROJECT COST MANAGEMENT......................................................................................... 193 7.1 Plan Cost Management........................................................................................... 195 7.1.1 Plan Cost Management: Inputs................................................................... 196 7.1.2 Plan Cost Management: Tools and Techniques.......................................... 198 7.1.3 Plan Cost Management: Outputs................................................................ 198 7.2 Estimate Costs......................................................................................................... 200 7.2.1 Estimate Costs: Inputs................................................................................ 202 7.2.2 Estimate Costs: Tools and Techniques....................................................... 204 7.2.3 Estimate Costs: Outputs.............................................................................. 207 7.3 Determine Budget.................................................................................................... 208 7.3.1 Determine Budget: Inputs........................................................................... 209 7.3.2 Determine Budget: Tools and Techniques.................................................. 211 7.3.3 Determine Budget: Outputs........................................................................ 212 7.4 Control Costs........................................................................................................... 215 7.4.1 Control Costs: Inputs................................................................................... 216 7.4.2 Control Costs: Tools and Techniques.......................................................... 217 7.4.3 Control Costs: Outputs................................................................................ 225 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 10. VI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 8. PROJECT QUALITY MANAGEMENT.................................................................................... 227 8.1 Plan Quality Management....................................................................................... 231 8.1.1 Plan Quality Management: Inputs.............................................................. 233 8.1.2 Plan Quality Management: Tools and Techniques..................................... 235 8.1.3 Plan Quality Management: Outputs............................................................ 241 8.2 Perform Quality Assurance..................................................................................... 242 8.2.1 Perform Quality Assurance: Inputs............................................................. 244 8.2.2 Perform Quality Assurance: Tools and Techniques.................................... 245 8.2.3 Perform Quality Assurance: Outputs.......................................................... 247 8.3 Control Quality......................................................................................................... 248 8.3.1 Control Quality: Inputs................................................................................ 250 8.3.2 Control Quality: Tools and Techniques....................................................... 252 8.3.3 Control Quality: Outputs.............................................................................. 252 9. PROJECT HUMAN RESOURCE MANAGEMENT................................................................... 255 9.1 Plan Human Resource Management....................................................................... 258 9.1.1 Plan Human Resource Management: Inputs.............................................. 259 9.1.2 Plan Human Resource Management: Tools and Techniques..................... 261 9.1.3 Plan Human Resource Management: Outputs........................................... 264 9.2 Acquire Project Team.............................................................................................. 267 9.2.1 Acquire Project Team: Inputs...................................................................... 269 9.2.2 Acquire Project Team: Tools and Techniques............................................. 270 9.2.3 Acquire Project Team: Outputs................................................................... 272 9.3 Develop Project Team.............................................................................................. 273 9.3.1 Develop Project Team: Inputs..................................................................... 274 9.3.2 Develop Project Team: Tools and Techniques............................................ 275 9.3.3 Develop Project Team: Outputs................................................................... 278 9.4 Manage Project Team.............................................................................................. 279 9.4.1 Manage Project Team: Inputs..................................................................... 281 9.4.2 Manage Project Team: Tools and Techniques............................................ 282 9.4.3 Manage Project Team: Outputs................................................................... 284 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 11. VII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 10. PROJECT COMMUNICATIONS MANAGEMENT................................................................. 287 10.1 Plan Communications Management..................................................................... 289 10.1.1 Plan Communications Management: Inputs............................................ 290 10.1.2 Plan Communications Management: Tools and Techniques................... 291 10.1.3 Plan Communications Management: Outputs..........................................296 10.2 Manage Communications..................................................................................... 297 10.2.1 Manage Communications: Inputs............................................................. 299 10.2.2 Manage Communications: Tools and Techniques.................................... 300 10.2.3 Manage Communications: Outputs.......................................................... 301 10.3 Control Communications....................................................................................... 303 10.3.1 Control Communications: Inputs.............................................................. 304 10.3.2 Control Communications: Tools and Techniques..................................... 306 10.3.3 Control Communications: Outputs............................................................ 307 11. PROJECT RISK MANAGEMENT........................................................................................ 309 11.1 Plan Risk Management......................................................................................... 313 11.1.1 Plan Risk Management: Inputs................................................................. 314 11.1.2 Plan Risk Management: Tools and Techniques........................................ 315 11.1.3 Plan Risk Management: Outputs.............................................................. 316 11.2 Identify Risks......................................................................................................... 319 11.2.1 Identify Risks: Inputs................................................................................ 321 11.2.2 Identify Risks: Tools and Techniques....................................................... 324 11.2.3 Identify Risks: Outputs.............................................................................. 327 11.3 Perform Qualitative Risk Analysis........................................................................ 328 11.3.1 Perform Qualitative Risk Analysis: Inputs................................................ 329 11.3.2 Perform Qualitative Risk Analysis: Tools and Techniques....................... 330 11.3.3 Perform Qualitative Risk Analysis: Outputs............................................. 333 11.4 Perform Quantitative Risk Analysis...................................................................... 333 11.4.1 Perform Quantitative Risk Analysis: Inputs............................................. 335 11.4.2 Perform Quantitative Risk Analysis: Tools and Techniques.................... 336 11.4.3 Perform Quantitative Risk Analysis: Outputs........................................... 341 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 12. VIII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 11.5 Plan Risk Responses............................................................................................. 342 11.5.1 Plan Risk Responses: Inputs.................................................................... 343 11.5.2 Plan Risk Responses: Tools and Techniques........................................... 343 11.5.3 Plan Risk Responses: Outputs.................................................................. 346 11.6 Control Risks......................................................................................................... 349 11.6.1 Control Risks: Inputs................................................................................. 350 11.6.2 Control Risks: Tools and Techniques........................................................ 351 11.6.3 Control Risks: Outputs.............................................................................. 353 12. PROJECT PROCUREMENT MANAGEMENT....................................................................... 355 12.1 Plan Procurement Management........................................................................... 358 12.1.1 Plan Procurement Management: Inputs................................................... 360 12.1.2 Plan Procurement Management: Tools and Techniques.......................... 365 12.1.3 Plan Procurement Management: Outputs................................................ 366 12.2 Conduct Procurements.......................................................................................... 371 12.2.1 Conduct Procurements: Inputs................................................................. 373 12.2.2 Conduct Procurements: Tools and Techniques........................................ 375 12.2.3 Conduct Procurements: Outputs.............................................................. 377 12.3 Control Procurements........................................................................................... 379 12.3.1 Control Procurements: Inputs................................................................... 381 12.3.2 Control Procurements: Tools and Techniques.......................................... 383 12.3.3 Control Procurements: Outputs................................................................ 384 12.4 Close Procurements.............................................................................................. 386 12.4.1 Close Procurements: Inputs...................................................................... 388 12.4.2 Close Procurements: Tools and Techniques............................................. 388 12.4.3 Close Procurements: Outputs................................................................... 389 13. PROJECT STAKEHOLDER MANAGEMENT........................................................................ 391 13.1 Identify Stakeholders............................................................................................ 393 13.1.1 Identify Stakeholders: Inputs.................................................................... 394 13.1.2 Identify Stakeholders: Tools and Techniques........................................... 395 13.1.3 Identify Stakeholders: Outputs................................................................. 398 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 13. IX ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition TABLE OF CONTENTS 13.2 Plan Stakeholder Management............................................................................. 399 13.2.1 Plan Stakeholder Management: Inputs.................................................... 400 13.2.2 Plan Stakeholder Management: Tools and Techniques........................... 401 13.2.3 Plan Stakeholder Management: Outputs.................................................. 403 13.3 Manage Stakeholder Engagement........................................................................ 404 13.3.1 Manage Stakeholder Engagement: Inputs............................................... 406 13.3.2 Manage Stakeholder Engagement: Tools and Techniques...................... 407 13.3.3 Manage Stakeholder Engagement: Outputs............................................. 408 13.4 Control Stakeholder Engagement......................................................................... 409 13.4.1 Control Stakeholder Engagement: Inputs................................................ 411 13.4.2 Control Stakeholder Engagement: Tools and Techniques....................... 412 13.4.3 Control Stakeholder Engagement: Outputs.............................................. 413 ANNEX A1 THE STANDARD FOR PROJECT MANAGEMENT OF A PROJECT........................... 417 APPENDIX X1 FIFTH EDITION CHANGES............................................................................... 463 Appendix X2 Contributors and Reviewers of the PMBOK® Guide – Fifth Edition....................................................................................................................... 483 APPENDIX X3 INTERPERSONAL SKILLS................................................................................ 513 REFERENCES......................................................................................................................... 521 Glossary............................................................................................................................. 523 INDEX.................................................................................................................................... 569 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 14. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 15. XI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures List of TABLES and Figures Figure 1-1. Portfolio, Program, and Project Management Interactions.................................................5 Figure 2-1. Functional Organization.....................................................................................................22 Figure 2-2. Weak Matrix Organization..................................................................................................23 Figure 2-3. Balanced Matrix Organization............................................................................................24 Figure 2-4. Strong Matrix Organization................................................................................................24 Figure 2-5. Projectized Organization....................................................................................................25 Figure 2-6. Composite Organization.....................................................................................................26 Figure 2-7. The Relationship Between Stakeholders and the Project.................................................31 Figure 2-8. Typical Cost and Staffing Levels Across a Generic Project Life Cycle Structure.............39 Figure 2-9. Impact of Variable Based on Project Time........................................................................40 Figure 2-10. Example of a Single-Phase Project....................................................................................42 Figure 2-11. Example of a Three-Phase Project.....................................................................................43 Figure 2-12. Example of a Project with Overlapping Phases.................................................................43 Figure 2-13. Example of Predictive Life Cycle........................................................................................44 Figure 3-1. Project Management Process Groups................................................................................50 Figure 3-2. Process Groups Interact in a Phase or Project..................................................................51 Figure 3-3. Project Management Process Interactions.......................................................................53 Figure 3-4. Project Boundaries.............................................................................................................54 Figure 3-5. Project Data, Information and Report Flow.......................................................................59 Figure 3-6. Data Flow Diagram Legend................................................................................................60 Figure 4-1. Project Integration Management Overview.......................................................................65 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 16. XII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 4-2. Develop Project Charter: Inputs, Tools and Techniques, and Outputs..............................66 Figure 4-3. Develop Project Charter Data Flow Diagram.....................................................................67 Figure 4-3. Develop Project Charter Data Flow Diagram.....................................................................72 Figure 4-5. Develop Project Management Plan Data Flow Diagram...................................................73 Figure 4-6. Direct and Manage Project Work: Inputs, Tools and Techniques, and Outputs................79 Figure 4-7. Direct and Manage Project Work: Data Flow Diagram......................................................80 Figure 4-8. Monitor and Control Project Work: Inputs, Tools Techniques, and Outputs..................86 Figure 4-9. Monitor and Control Project Work Data Flow Diagram.....................................................87 Figure 4-10. Perform Integrated Change Control: Inputs, Tools Techniques, and Outputs...............94 Figure 4-11. Perform Integrated Change Control Data Flow Diagram..................................................95 Figure 4-12. Close Project or Phase: Inputs, Tools Techniques, and Outputs..................................100 Figure 4-13. Close Project or Phase Data Flow Diagram.....................................................................101 Figure 5-1. Project Scope Management Overview.............................................................................106 Figure 5-2. Plan Scope Management: Inputs, Tools Techniques, and Outputs..............................107 Figure 5-3. Plan Scope Management Data Flow Diagram.................................................................107 Figure 5-4. Collect Requirements: Inputs, Tools Techniques, and Outputs...................................111 Figure 5-5. Collect Requirements Data Flow Diagram.......................................................................111 Figure 5-6. Example of a Requirements Traceability Matrix..............................................................119 Figure 5-7. Define Scope: Inputs, Tools Techniques, and Outputs.................................................120 Figure 5-8. Define Scope Data Flow Diagram....................................................................................120 Figure 5-9. Create WBS: Inputs, Tools Techniques, and Outputs...................................................125 Figure 5-10. Create WBS Data Flow Diagram.......................................................................................126 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 17. XIII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 5-11. Sample WBS Decomposed Down Through Work Packages............................................129 Figure 5-12. Sample WBS Organized by Phase....................................................................................130 Figure 5-13. Sample WBS with Major Deliverables..............................................................................130 Figure 5-14. Validate Scope: Inputs, Tools Techniques, and Outputs..............................................133 Figure 5-15. Validate Scope Data Flow Diagram..................................................................................133 Figure 5-16. Control Scope: Inputs, Tools Techniques, and Outputs................................................136 Figure 5-17. Control Scope Data Flow Diagram...................................................................................137 Figure 6-1. Project Time Management Overview...............................................................................143 Figure 6-2. Scheduling Overview........................................................................................................144 Figure 6-3. Plan Schedule Management: Inputs, Tools Techniques, and Outputs.........................145 Figure 6-4. Plan Schedule Management Data Flow Diagram............................................................145 Figure 6-5. Define Activities: Inputs, Tools Techniques, and Outputs............................................149 Figure 6-6. Define Activities Data Flow Diagram...............................................................................150 Figure 6-7. Sequence Activities: Inputs, Tools Techniques, and Outputs......................................153 Figure 6-8. Sequence Activities Data Flow Diagram..........................................................................154 Figure 6-9. Precedence Diagramming Method (PDM) Relationship Types.......................................157 Figure 6-10. Examples of Lead and Lag...............................................................................................158 Figure 6-11. Project Schedule Network Diagram.................................................................................160 Figure 6-12. Estimate Activity Resources: Inputs, Tools Techniques, and Outputs.........................161 Figure 6-13. Estimate Activity Resources Data Flow Diagram............................................................161 Figure 6-14. Estimate Activity Durations: Inputs, Tools Techniques, and Outputs..........................166 Figure 6-15. Estimate Activity Durations Data Flow Diagram.............................................................166 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 18. XIV ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 6-16 Develop Schedule: Inputs, Tools Techniques, and Outputs.........................................173 Figure 6-17. Develop Schedule Data Flow Diagram.............................................................................173 Figure 6-18. Example of Critical Path Method......................................................................................177 Figure 6-19. Example of Critical Chain Method....................................................................................178 Figure 6-20. Resource Leveling............................................................................................................179 Figure 6-21. Project Schedule Presentations —Examples..................................................................183 Figure 6-22. Control Schedule: Inputs, Tools Techniques, and Outputs...........................................185 Figure 6-23. Control Schedule Data Flow Diagram..............................................................................186 Figure 7-1. Project Cost Management Overview................................................................................194 Figure 7-2. Plan Cost Management: Inputs, Tools Techniques, and Outputs.................................195 Figure 7-3. Plan Cost Management: Data Flow Diagram...................................................................196 Figure 7-4. Estimate Costs: Inputs, Tools Techniques, and Outputs..............................................200 Figure 7-5. Estimate Costs Data Flow Diagram.................................................................................201 Figure 7-6. Determine Budget: Inputs, Tools Techniques, and Outputs.........................................208 Figure 7-7. Determine Budget Data Flow Diagram............................................................................209 Figure 7-8. Project Budget Components.............................................................................................213 Figure 7-9. Cost Baseline, Expenditures, and Funding Requirements..............................................214 Figure 7-10. Control Costs: Inputs, Tools Techniques, and Outputs.................................................215 Figure 7-11. Control Costs Data Flow Diagram....................................................................................215 Figure 7-12. Earned Value, Planned Value, and Actual Costs..............................................................219 Figure 7-13. To-Complete Performance Index (TCPI)...........................................................................222 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 19. XV ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 8-1. Project Quality Management Overview............................................................................230 Figure 8-2. Fundamental Relationships of Quality Assurance and Control Quality to the IPECC, PDCA, Cost of Quality Models and Project Management Process Groups.....................231 Figure 8-3. Plan Quality Management Inputs, Tools Techniques, and Outputs.............................232 Figure 8-4. Plan Quality Management Data Flow Diagram................................................................232 Figure 8-5. Cost of Quality...................................................................................................................235 Figure 8-6. The SIPOC Model...............................................................................................................237 Figure 8-7. Storyboard Illustrating a Conceptual Example of Each of the Seven Basic Quality Tools...........................................................................................................239 Figure 8-8. Perform Quality Assurance: Inputs, Tools Techniques, and Outputs...........................243 Figure 8-9. Perform Quality Assurance Data Flow Diagram..............................................................243 Figure 8-10. Storyboard Illustrating the Seven Quality Management and Control Tools...................246 Figure 8-11. Control Quality: Inputs, Tools Techniques, and Outputs..............................................249 Figure 8-12. Control Quality Data Flow Diagram..................................................................................249 Figure 9-1. Project Human Resource Management Overview...........................................................257 Figure 9-2. Plan Human Resource Management: Inputs, Tools Techniques, and Outputs............258 Figure 9-3. Plan Human Resource Management Data Flow Diagram...............................................258 Figure 9-4. Roles and Responsibility Definition Formats...................................................................261 Figure 9-5. RACI Matrix.......................................................................................................................262 Figure 9-6. Illustrative Resource Histogram......................................................................................266 Figure 9-7. Acquire Project Team: Inputs, Tools Techniques, and Outputs....................................267 Figure 9-8. Acquire Project Team Data Flow Diagram.......................................................................268 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 20. XVI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 9-9. Develop Project Team: Inputs, Tools Techniques, and Outputs...................................273 Figure 9-10. Develop Project Team Data Flow Diagram......................................................................273 Figure 9-11. Manage Project Team: Inputs, Tools Techniques, and Outputs...................................279 Figure 9-12. Manage Project Team Data Flow Diagram......................................................................280 Figure 10-1. Project Communications Management Overview...........................................................288 Figure 10-2. Plan Communications Management: Inputs, Tools Techniques, and Outputs............289 Figure 10-3. Plan Communications Management Data Flow Diagram...............................................289 Figure 10-4. Basic Communication Model...........................................................................................294 Figure 10-5. Manage Communications: Inputs, Tools Techniques, and Outputs.............................297 Figure 10-6. Manage Communications Data Flow Diagram................................................................298 Figure 10-7. Control Communications: Inputs, Tools Techniques, and Outputs..............................303 Figure 10-8. Control Communications Data Flow Diagram.................................................................304 Figure 11-1. Project Risk Management Overview................................................................................312 Figure 11-2. Plan Risk Management: Inputs, Tools Techniques, and Outputs.................................313 Figure 11-3. Plan Risk Management Data Flow Diagram....................................................................313 Figure 11-4. Example of a Risk Breakdown Structure (RBS)..............................................................317 Figure 11-5. Identify Risks: Inputs, Tools Techniques, and Outputs................................................319 Figure 11-6. Identify Risks Data Flow Diagram...................................................................................320 Figure 11-7. Influence Diagram............................................................................................................326 Figure 11-8. Perform Qualitative Risk Analysis: Inputs, Tools Techniques, and Outputs................328 Figure 11-9. Perform Qualitative Risk Analysis Data Flow Diagram...................................................328 Figure 11-10. Probability and Impact Matrix.........................................................................................331 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 21. XVII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 11-11. Perform Quantitative Risk Analysis: Inputs, Tools Techniques, and Outputs.............334 Figure 11-12. Perform Quantitative Risk Analysis Data Flow Diagram.................................................334 Figure 11-13. Range of Project Cost Estimates Collected During the Risk Interview.........................336 Figure 11-14. Examples of Commonly Used Probability Distributions..................................................337 Figure 11-15. Example of Tornado Diagram...........................................................................................338 Figure 11-16. Decision Tree Diagram.....................................................................................................339 Figure 11-17. Cost Risk Simulation Results...........................................................................................340 Figure 11-18. Plan Risk Responses: Inputs, Tools Techniques, and Outputs....................................342 Figure 11-19. Plan Risk Responses Data Flow Diagram........................................................................342 Figure 11-20. Control Risks: Inputs, Tools Techniques, and Outputs.................................................349 Figure 11-21. Control Risks Data Flow Diagram....................................................................................349 Figure 12-1. Project Procurement Management Overview..................................................................356 Figure 12-2. Plan Procurements: Inputs, Tools Techniques, and Outputs.......................................358 Figure 12-3. Plan Procurement Management Data Flow Diagram......................................................359 Figure 12-4. Conduct Procurements: Inputs, Tools Techniques, and Outputs.................................371 Figure 12-5. Conduct Procurements Data Flow Diagram....................................................................372 Figure 12-6. Control Procurements: Inputs, Tools Techniques, and Outputs...................................379 Figure 12-7. Control Procurements Data Flow Diagram......................................................................380 Figure 12-8. Close Procurements: Inputs, Tools Techniques, and Outputs......................................386 Figure 12-9. Close Procurements Data Flow Diagram.........................................................................387 Figure 13-1. Project Stakeholder Management Overview...................................................................392 Figure 13-2. Identify Stakeholders: Inputs, Tools Techniques, and Outputs....................................393 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 22. XVIII ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure 13-3. Identify Stakeholders Data Flow Diagram.......................................................................393 Figure 13-4. Example Power/Interest Grid with Stakeholders............................................................397 Figure 13-5. Plan Stakeholder Management: Inputs, Tools Techniques, and Outputs....................399 Figure 13-6. Plan Stakeholder Management Data Flow Diagram.......................................................399 Figure 13-7. Stakeholders Engagement Assessment Matrix...............................................................403 Figure 13-8. Manage Stakeholder Engagement: Inputs, Tools Techniques, and Outputs...............404 Figure 13-9. Manage Stakeholder Engagement Data Flow Diagram..................................................405 Figure 13-10. Control Stakeholder Engagement: Inputs, Tools Techniques, and Outputs................410 Figure 13-11. Control Stakeholder Engagement: Data Flow Diagram...................................................410 Figure A1-1. Process Group Interactions in a Project..........................................................................419 Figure A1-2. Project Management Process Interactions.....................................................................421 Figure A1-3. Project Boundaries...........................................................................................................425 Figure A1-4. Initiating Process Group...................................................................................................425 Figure A1-5. Develop Project Charter: Inputs and Outputs..................................................................426 Figure A1-6. Identify Stakeholders: Inputs and Outputs......................................................................426 Figure A1-7. Planning Process Group...................................................................................................428 Figure A1-8. Develop Project Management Plan: Inputs and Outputs................................................429 Figure A1-9. Plan Scope Management: Inputs and Outputs................................................................429 Figure A1-10. Collect Requirements: Inputs and Outputs......................................................................430 Figure A1-11. Define Scope: Inputs and Outputs...................................................................................430 Figure A1-12. Create WBS: Inputs and Outputs......................................................................................431 Figure A1-13. Plan Schedule Management: Inputs and Outputs...........................................................431 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 23. XIX ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure A1-14. Define Activities: Inputs and Outputs..............................................................................432 Figure A1-15. Sequence Activities: Inputs and Outputs.........................................................................432 Figure A1-16. Estimate Activity Resources: Inputs and Outputs...........................................................433 Figure A1-17. Estimate Activity Durations: Inputs and Outputs............................................................434 Figure A1-18. Develop Schedule: Inputs and Outputs............................................................................435 Figure A1-19. Plan Cost Management: Inputs and Outputs...................................................................436 Figure A1-20. Estimate Costs: Inputs and Outputs.................................................................................436 Figure A1-21. Determine Budget: Inputs and Outputs...........................................................................437 Figure A1-22. Plan Quality Management: Inputs and Outputs...............................................................438 Figure A1-23. Plan Human Resource Management: Inputs and Outputs..............................................438 Figure A1-24. Plan Communications Management: Inputs and Outputs..............................................439 Figure A1-25. Plan Risk Management: Inputs and Outputs...................................................................439 Figure A1-26. Identify Risks: Inputs and Outputs...................................................................................440 Figure A1-27. Perform Qualitative Risk Analysis: Inputs and Outputs..................................................441 Figure A1-28. Perform Quantitative Risk Analysis: Inputs and Outputs................................................441 Figure A1-29. Plan Risk Responses: Inputs and Outputs.......................................................................442 Figure A1-30. Plan Procurement Management: Inputs and Outputs.....................................................443 Figure A1-31. Plan Stakeholder Management: Inputs and Outputs......................................................443 Figure A1-32. Executing Process Group.................................................................................................445 Figure A1-33. Direct and Manage Project Work: Inputs and Outputs....................................................446 Figure A1-34. Perform Quality Assurance: Inputs and Outputs.............................................................446 Figure A1-35. Acquire Project Team: Inputs and Outputs......................................................................447 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 24. XX ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure A1-36. Develop Project Team: Inputs and Outputs......................................................................447 Figure A1-37. Manage Project Team: Inputs and Outputs......................................................................448 Figure A1-38. Manage Communications: Inputs and Outputs...............................................................448 Figure A1-39. Conduct Procurements: Inputs and Outputs...................................................................449 Figure A1-40. Manage Stakeholder Engagement: Inputs and Outputs.................................................450 Figure A1-41. Monitoring and Controlling Process Group.....................................................................451 Figure A1-42. Monitor and Control Project Work: Inputs and Outputs..................................................452 Figure A1-43. Perform Integrated Change Control: Inputs and Outputs................................................453 Figure A1-44. Validate Scope: Inputs and Outputs.................................................................................453 Figure A1-45. Control Scope: Inputs and Outputs..................................................................................454 Figure A1-46. Control Schedule: Inputs and Outputs.............................................................................455 Figure A1-47. Control Costs: Inputs and Outputs...................................................................................455 Figure A1-48. Control Quality: Inputs and Outputs.................................................................................456 Figure A1-49. Control Communications: Inputs and Outputs................................................................457 Figure A1-50. Control Risks: Inputs and Outputs...................................................................................457 Figure A1-51. Control Procurements: Inputs and Outputs.....................................................................458 Figure A1-52. Control Stakeholder Engagement: Inputs and Outputs...................................................459 Figure A1-53. Closing Process Group.....................................................................................................460 Figure A1-54. Close Project or Phase: Inputs and Outputs....................................................................461 Figure A1-55. Close Procurements: Inputs and Outputs........................................................................461 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 25. XXI ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition List of TABLES and Figures Figure X1-1. Refined Data Model..........................................................................................................467 Table 1-1. Comparative Overview of Project, Program, and Portfolio Management...........................8 Table 2-1. Influence of Organizational Structures on Projects..........................................................22 Table 3-1. Project Management Process Group and Knowledge Area Mapping...............................61 Table 4-1 Differentiation Between the Project Management Plan and Project Documents............78 Table 5-1. Elements of the Project Charter and Project Scope Statement......................................124 Table 7-1. Earned Value Calculations Summary Table.....................................................................224 Table 11-1. Definition of Impact Scales for Four Project Objectives.................................................318 Table A1-1. Project Management Process Group and Knowledge Area Mapping.............................423 Table X1-1. Section 4 Changes............................................................................................................472 Table X1-2. Section 5 Changes............................................................................................................473 Table X1-3. Section 6 Changes............................................................................................................474 Table X1-4. Section 7 Changes............................................................................................................475 Table X1-5. Section 8 Changes............................................................................................................476 Table X1-6. Section 9 Changes............................................................................................................477 Table X1-7. Section 10 Changes..........................................................................................................478 Table X1-8. Section 11 Changes..........................................................................................................479 Table X1-9. Section 12 Changes..........................................................................................................480 Table X1-10. Section 13 Changes..........................................................................................................481 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 26. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 27. 1 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION Introduction A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition provides guidelines for managing individual projects and defines project management related concepts. It also describes the project management life cycle and its related processes, as well as the project life cycle. The PMBOK® Guide contains the globally recognized standard and guide for the project management profession (found in Annex A1). A standard is a formal document that describes established norms, methods, processes, and practices. As with other professions, the knowledge contained in this standard has evolved from the recognized good practices of project management practitioners who have contributed to the development of this standard. The first two sections of the PMBOK® Guide provide an introduction to key concepts in the project management field. Section 3 summarizes the Process Groups and provides an overview of process interactions among the ten Knowledge Areas and five Process Groups. Sections 4 through 13 are the guide to the project management body of knowledge.These sections expand on the information in the standard by describing the inputs and outputs, as well as tools and techniques used in managing projects.Annex A1 is the standard for project management and presents the processes, inputs, and outputs that are considered to be good practice on most projects most of the time. This section defines several key terms and the relationship among portfolio management,program management, project management and organizational project management. An overview of the PMBOK® Guide is found within the following sections: 1.1 Purpose of the PMBOK® Guide 1.2 What is a Project? 1.3 What is Project Management? 1.4 Relationships Among Portfolio Management, Program Management, Project Management,and Organizational Project Management 1.5 Relationship Between Project Management, Operations Management, and Organizational Strategy 1.6 Business Value 1.7 Role of the Project Manager 1.8 Project Management Body of Knowledge 1 1 Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 28. 2 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION 1.1 Purpose of the PMBOK® Guide The acceptance of project management as a profession indicates that the application of knowledge, processes, skills, tools, and techniques can have a significant impact on project success. The PMBOK® Guide identifies that subset of the project management body of knowledge that is generally recognized as good practice. “Generally recognized” means the knowledge and practices described are applicable to most projects most of the time, and there is consensus about their value and usefulness. “Good practice” means there is general agreement that the application of the knowledge, skills, tools, and techniques can enhance the chances of success over many projects. “Good practice” does not mean that the knowledge described should always be applied uniformly to all projects; the organization and/or project management team is responsible for determining what is appropriate for any given project. The PMBOK® Guide also provides and promotes a common vocabulary within the project management profession for using and applying project management concepts. A common vocabulary is an essential element of a professional discipline.The PMI Lexicon of Project Management Terms [1]1 provides the foundational professional vocabulary that can be consistently used by project, program, and portfolio managers and other stakeholders. Annex A1 is a foundational reference for PMI’s project management professional development programs. Annex A1 continues to evolve along with the profession, and is therefore not all-inclusive; this standard is a guide rather than a specific methodology. One can use different methodologies and tools (e.g., agile, waterfall, PRINCE2) to implement the project management framework. In addition to the standards that establish guidelines for project management processes,the Project Management Institute Code of Ethics and Professional Conduct [2] guides practitioners of the profession and describes the expectations that practitioners should hold for themselves and others. The Project Management Institute Code of Ethics and Professional Conduct is specific about the basic obligation of responsibility, respect, fairness, and honesty. It requires that practitioners demonstrate a commitment to ethical and professional conduct. It carries the obligation to comply with laws, regulations, and organizational and professional policies. Practitioners come from diverse backgrounds and cultures, and the Project Management Institute Code of Ethics and Professional Conduct applies globally. When interacting with any stakeholder, practitioners should be committed to honest, responsible, fair practices and respectful dealings.Acceptance of the code is essential for project managers, and is a requirement for the following PMI® exams: • Certified Associate in Project Management (CAPM)® • Project Management Professional (PMP)® • Program Management Professional (PgMP)® • PMI Agile Certified Practitioner (PMI-ACP)SM • PMI Risk Management Professional (PMI-RMP)® • PMI Scheduling Professional (PMI-SP)® 1 The numbers in brackets refer to the list of references at the end of this standard. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 29. 3 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION 1.2 What is a Project? A project is a temporary endeavor undertaken to create a unique product, service, or result. The temporary nature of projects indicates that a project has a definite beginning and end. The end is reached when the project’s objectives have been achieved or when the project is terminated because its objectives will not or cannot be met, or when the need for the project no longer exists. A project may also be terminated if the client (customer, sponsor, or champion) wishes to terminate the project. Temporary does not necessarily mean the duration of the project is short. It refers to the project’s engagement and its longevity. Temporary does not typically apply to the product, service, or result created by the project; most projects are undertaken to create a lasting outcome. For example, a project to build a national monument will create a result expected to last for centuries. Projects can also have social, economic, and environmental impacts that far outlive the projects themselves. Every project creates a unique product, service, or result. The outcome of the project may be tangible or intangible. Although repetitive elements may be present in some project deliverables and activities, this repetition does not change the fundamental, unique characteristics of the project work. For example, office buildings can be constructed with the same or similar materials and by the same or different teams. However, each building project remains unique with a different location, different design, different circumstances and situations, different stakeholders, and so on. An ongoing work effort is generally a repetitive process that follows an organization’s existing procedures. In contrast, because of the unique nature of projects, there may be uncertainties or differences in the products, services, or results that the project creates. Project activities can be new to members of a project team, which may necessitate more dedicated planning than other routine work. In addition, projects are undertaken at all organizational levels.A project can involve a single individual or multiple individuals, a single organizational unit, or multiple organizational units from multiple organizations. A project can create: • A product that can be either a component of another item, an enhancement of an item, or an end item in itself; • A service or a capability to perform a service (e.g., a business function that supports production or distribution); • An improvement in the existing product or service lines (e.g., A Six Sigma project undertaken to reduce defects); or • A result, such as an outcome or document (e.g., a research project that develops knowledge that can be used to determine whether a trend exists or a new process will benefit society). Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 30. 4 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION Examples of projects include, but are not limited to: • Developing a new product, service, or result; • Effecting a change in the structure, processes, staffing, or style of an organization; • Developing or acquiring a new or modified information system (hardware or software); • Conducting a research effort whose outcome will be aptly recorded; • Constructing a building, industrial plant, or infrastructure; or • Implementing, improving, or enhancing existing business processes and procedures. 1.2.1. The Relationships Among Portfolios, Programs, and Projects The relationship among portfolios, programs, and projects is such that a portfolio refers to a collection of projects, programs, subportfolios, and operations managed as a group to achieve strategic objectives. Programs are grouped within a portfolio and are comprised of subprograms, projects, or other work that are managed in a coordinated fashion in support of the portfolio. Individual projects that are either within or outside of a program are still considered part of a portfolio. Although the projects or programs within the portfolio may not necessarily be interdependent or directly related, they are linked to the organization’s strategic plan by means of the organization’s portfolio. As Figure 1-1 illustrates, organizational strategies and priorities are linked and have relationships between portfolios and programs, and between programs and individual projects. Organizational planning impacts the projects by means of project prioritization based on risk, funding, and other considerations relevant to the organization’s strategic plan. Organizational planning can direct the management of resources, and support for the component projects on the basis of risk categories, specific lines of business, or general types of projects, such as infrastructure and process improvement. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 31. 5 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION Projects Portfolio Subportfolios Programs Subprograms Projects Projects Projects • Strategies and priorities • Progressive elaboration • Governance • Disposition on requested changes • Impacts from changes in other portfolios, programs, or projects • Strategies and priorities • Progressive elaboration • Governance • Disposition on requested changes • Impacts from changes in other portfolios, programs, or projects • Strategies and priorities • Progressive elaboration • Governance • Disposition on requested changes • Impacts from changes in other portfolios, programs, or projects • Performance reports • Change requests with impact on other portfolios, programs, or projects • Performance reports • Change requests with impact on other portfolios, programs, or projects • Performance reports • Change requests with impact on other portfolios, programs, or projects Programs Subprograms Projects Projects Figure 1-1. Portfolio, Program, and Project Management Interactions 1.3 What is Project Management? Project management is the application of knowledge, skills, tools, and techniques to project activities to meet the project requirements. Project management is accomplished through the appropriate application and integration of the 47 logically grouped project management processes, which are categorized into five Process Groups.These five Process Groups are: • Initiating, • Planning, • Executing, • Monitoring and Controlling, and • Closing. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 32. 6 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION Managing a project typically includes, but is not limited to: • Identifying requirements; • Addressing the various needs, concerns, and expectations of the stakeholders in planning and executing the project; • Setting up, maintaining, and carrying out communications among stakeholders that are active, effective, and collaborative in nature; • Managing stakeholders towards meeting project requirements and creating project deliverables; • Balancing the competing project constraints, which include, but are not limited to: ○ ○ Scope, ○ ○ Quality, ○ ○ Schedule, ○ ○ Budget, ○ ○ Resources, and ○ ○ Risks. The specific project characteristics and circumstances can influence the constraints on which the project management team needs to focus. The relationship among these factors is such that if any one factor changes, at least one other factor is likely to be affected. For example, if the schedule is shortened, often the budget needs to be increased to add additional resources to complete the same amount of work in less time. If a budget increase is not possible, the scope or targeted quality may be reduced to deliver the project’s end result in less time within the same budget amount. Project stakeholders may have differing ideas as to which factors are the most important, creating an even greater challenge. Changing the project requirements or objectives may create additional risks. The project team needs to be able to assess the situation, balance the demands, and maintain proactive communication with stakeholders in order to deliver a successful project. Due to the potential for change, the development of the project management plan is an iterative activity and is progressively elaborated throughout the project’s life cycle.Progressive elaboration involves continuously improving and detailing a plan as more detailed and specific information and more accurate estimates become available. Progressive elaboration allows a project management team to define work and manage it to a greater level of detail as the project evolves. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 33. 7 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION 1.4 Relationships Among Portfolio Management, Program Management, Project Management, and Organizational Project Management In order to understand portfolio, program, and project management, it is important to recognize the similarities and differences among these disciplines. It is also helpful to understand how they relate to organizational project management (OPM). OPM is a strategy execution framework utilizing project, program, and portfolio management as well as organizational enabling practices to consistently and predictably deliver organizational strategy producing better performance, better results, and a sustainable competitive advantage. Portfolio, program, and project management are aligned with or driven by organizational strategies. Conversely, portfolio,program,and project management differ in the way each contributes to the achievement of strategic goals. Portfolio management aligns with organizational strategies by selecting the right programs or projects, prioritizing the work,and providing the needed resources,whereas program management harmonizes its projects and program components and controls interdependencies in order to realize specified benefits. Project management develops and implements plans to achieve a specific scope that is driven by the objectives of the program or portfolio it is subjected to and, ultimately, to organizational strategies. OPM advances organizational capability by linking project, program, and portfolio management principles and practices with organizational enablers (e.g. structural, cultural, technological, and human resource practices) to support strategic goals. An organization measures its capabilities, then plans and implements improvements towards the systematic achievement of best practices. Table 1-1 shows the comparison of project, program, and portfolio views across several dimensions within the organization. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 34. 8 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION Table 1-1. Comparative Overview of Project, Program, and Portfolio Management Organizational Project Management Projects Programs Portfolios Projects have defined objectives. Scope is progres- sively elaborated throughout the project life cycle. Project managers expect change and implement processes to keep change managed and controlled. Project managers progressively elaborate high-level information into detailed plans throughout the project life cycle. Project managers manage the project team to meet the project objectives. Success is measured by product and project quality, timeliness, budget compliance, and degree of customer satisfaction. Project managers monitor and control the work of producing the products, services, or results that the project was undertaken to produce. Programs have a larger scope and provide more significant benefits. Program managers expect change from both inside and outside the program and are prepared to manage it. Program managers develop the overall program plan and create high-level plans to guide detailed planning at the component level. Program managers manage the program staff and the project managers; they provide vision and overall leadership. Success is measured by the degree to which the program satisfies the needs and benefits for which it was undertaken. Program managers monitor the progress of program components to ensure the overall goals, schedules, budget, and benefits of the program will be met. Portfolios have an organizational scope that changes with the strategic objectives of the organization. Portfolio managers continuously monitor changes in the broader internal and external environment. Portfolio managers create and maintain necessary processes and communication relative to the aggregate portfolio. Portfolio managers may manage or coordinate portfolio management staff, or program and project staff that may have reporting responsibilities into the aggregate portfolio. Success is measured in terms of the aggregate investment performance and benefit realization of the portfolio. Portfolio managers monitor strategic changes and aggregate resource allocation, performance results, and risk of the portfolio. Scope Change Planning Management Success Monitoring Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 35. 9 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION 1.4.1 Program Management A program is defined as a group of related projects, subprograms, and program activities managed in a coordinated way to obtain benefits not available from managing them individually. Programs may include elements of related work outside the scope of the discrete projects in the program. A project may or may not be part of a program but a program will always have projects. Program management is the application of knowledge, skills, tools, and techniques to a program in order to meet the program requirements and to obtain benefits and control not available by managing projects individually. Projects within a program are related through the common outcome or collective capability. If the relationship between projects is only that of a shared client, seller, technology, or resource, the effort should be managed as a portfolio of projects rather than as a program. Program management focuses on the project interdependencies and helps to determine the optimal approach for managing them. Actions related to these interdependencies may include: • Resolving resource constraints and/or conflicts that affect multiple projects within the program, • Aligning organizational/strategic direction that affects project and program goals and objectives, and • Resolving issues and change management within a shared governance structure. An example of a program is a new communications satellite system with projects for design of the satellite and the ground stations, the construction of each, the integration of the system, and the launch of the satellite. 1.4.2 Portfolio Management A portfolio refers to projects, programs, subportfolios, and operations managed as a group to achieve strategic objectives. The projects or programs of the portfolio may not necessarily be interdependent or directly related. For example, an infrastructure firm that has the strategic objective of “maximizing the return on its investments” may put together a portfolio that includes a mix of projects in oil and gas, power, water, roads, rail, and airports. From this mix, the firm may choose to manage related projects as one program.All of the power projects may be grouped together as a power program. Similarly, all of the water projects may be grouped together as a water program. Thus, the power program and the water program become integral components of the enterprise portfolio of the infrastructure firm. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 36. 10 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION Portfolio management refers to the centralized management of one or more portfolios to achieve strategic objectives. Portfolio management focuses on ensuring that projects and programs are reviewed to prioritize resource allocation, and that the management of the portfolio is consistent with and aligned to organizational strategies. 1.4.3 Projects and Strategic Planning Projects are often utilized as a means of directly or indirectly achieving objectives within an organization’s strategic plan. Projects are typically authorized as a result of one or more of the following strategic considerations: • Market demand (e.g., a car company authorizing a project to build more fuel-efficient cars in response to gasoline shortages); • Strategic opportunity/business need (e.g., a training company authorizing a project to create a new course to increase its revenues); • Social need (e.g., a nongovernmental organization in a developing country authorizing a project to provide potable water systems, latrines, and sanitation education to communities suffering from high rates of infectious diseases); • Environmental consideration (e.g., a public company authorizing a project to create a new service for electric car sharing to reduce pollution); • Customer request (e.g., an electric utility authorizing a project to build a new substation to serve a new industrial park); • Technological advance (e.g., an electronics firm authorizing a new project to develop a faster, cheaper, and smaller laptop based on advances in computer memory and electronics technology); and • Legal requirement (e.g., a chemical manufacturer authorizing a project to establish guidelines for proper handling of a new toxic material). 1.4.4 Project Management Office A project management office (PMO) is a management structure that standardizes the project-related governance processes and facilitates the sharing of resources, methodologies, tools, and techniques. The responsibilities of a PMO can range from providing project management support functions to actually being responsible for the direct management of one or more projects. There are several types of PMO structures in organizations, each varying in the degree of control and influence they have on projects within the organization, such as: Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 37. 11 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION • Supportive. Supportive PMOs provide a consultative role to projects by supplying templates, best practices, training, access to information and lessons learned from other projects. This type of PMO serves as a project repository. The degree of control provided by the PMO is low. • Controlling. Controlling PMOs provide support and require compliance through various means. Compliance may involve adopting project management frameworks or methodologies, using specific templates, forms and tools, or conformance to governance. The degree of control provided by the PMO is moderate. • Directive. Directive PMOs take control of the projects by directly managing the projects. The degree of control provided by the PMO is high. The PMO integrates data and information from corporate strategic projects and evaluates how higher level strategic objectives are being fulfilled. The PMO is the natural liaison between the organization’s portfolios, programs, projects, and the corporate measurement systems (e.g. balanced scorecard). The projects supported or administered by the PMO may not be related, other than by being managed together. The specific form, function, and structure of a PMO are dependent upon the needs of the organization that it supports. A PMO may have the authority to act as an integral stakeholder and a key decision maker throughout the life of each project, to make recommendations, or to terminate projects or take other actions, as required, to remain aligned with the business objectives. In addition, the PMO may be involved in the selection, management, and deployment of shared or dedicated project resources. A primary function of a PMO is to support project managers in a variety of ways which may include, but are not limited to: • Managing shared resources across all projects administered by the PMO; • Identifying and developing project management methodology, best practices, and standards; • Coaching, mentoring, training, and oversight; • Monitoring compliance with project management standards,policies,procedures,and templates by means of project audits; • Developing and managing project policies, procedures, templates, and other shared documentation (organizational process assets); and • Coordinating communication across projects. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 38. 12 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 - INTRODUCTION Project managers and PMOs pursue different objectives and, as such, are driven by different requirements. All of these efforts are aligned with the strategic needs of the organization. Differences between the role of project managers and a PMO may include the following: • The project manager focuses on the specified project objectives, while the PMO manages major program scope changes, which may be seen as potential opportunities to better achieve business objectives. • The project manager controls the assigned project resources to best meet project objectives, while the PMO optimizes the use of shared organizational resources across all projects. • The project manager manages the constraints (scope, schedule, cost, quality, etc.) of the individual projects, while the PMO manages the methodologies, standards, overall risks/opportunities, metrics, and interdependencies among projects at the enterprise level. 1.5 Relationship Between Project Management, Operations Management, and Organizational Strategy Operations management is responsible for overseeing,directing,and controlling business operations.Operations evolve to support the day-to-day business,and are necessary to achieve strategic and tactical goals of the business. Examples include: production operations, manufacturing operations, accounting operations, software support, and maintenance. Though temporary in nature, projects can help achieve the organizational goals when they are aligned with the organization’s strategy.Organizations sometimes change their operations,products,or systems by creating strategic business initiatives that are developed and implemented through projects. Projects require project management activities and skill sets,while operations require business process management,operations management activities, and skill sets. 1.5.1 Operations and Project Management Changes in business operations may be the focus of a dedicated project—especially if there are substantial changes to business operations as a result of a new product or service delivery. Ongoing operations are outside of the scope of a project; however, there are intersecting points where the two areas cross. Projects can intersect with operations at various points during the product life cycle, such as: Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
  • 39. 13 ©2013 Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK® Guide) – Fifth Edition 1 1 - INTRODUCTION • At each closeout phase; • When developing a new product, upgrading a product, or expanding outputs; • While improving operations or the product development process; or • Until the end of the product life cycle. At each point,deliverables and knowledge are transferred between the project and operations for implementation of the delivered work. This implementation occurs through a transfer of project resources to operations toward the end of the project, or through a transfer of operational resources to the project at the start. Operations are ongoing endeavors that produce repetitive outputs, with resources assigned to do basically the same set of tasks according to the standards institutionalized in a product life cycle. Unlike the ongoing nature of operations, projects are temporary endeavors. 1.5.1.1 Operations Management Operations management is a subject area that is outside the scope of formal project management as described in this standard. Operations management is an area of management concerned with ongoing production of goods and/or services. It involves ensuring that business operations continue efficiently by using the optimum resources needed and meeting customer demands. It is concerned with managing processes that transform inputs (e.g., materials, components, energy, and labor) into outputs (e.g., products, goods, and/or services). 1.5.1.2 Operational Stakeholders in Project Management While operations management is different from project management (see 1.5.1.1), the needs of stakeholders who perform and conduct business operations are important considerations in projects that will affect their future work and endeavors. Project managers who consider and appropriately include operational stakeholders in all phases of projects, gain insight and avoid unnecessary issues that often arise when their input is overlooked. Operational stakeholders should be engaged and their needs identified as part of the stakeholder register, and their influence (positive or negative) should be addressed as part of the risk management plan. Licensed To: Jorge Diego Fuentes Sanchez PMI MemberID: 2399412 This copy is a PMI Member benefit, not for distribution, sale, or reproduction.
