Rebuilding the Community Centre  Los Coipos

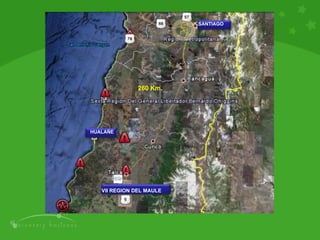

Where are we? 260 Km.  SANTIAGO HUALAÑE VII REGION DEL MAULE

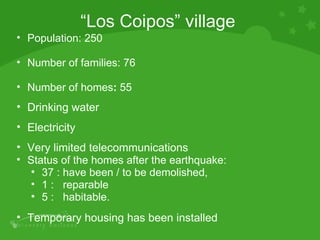

Population: 250  Number of families: 76 Number of homes :  55 Drinking water  Electricity  Very limited telecommunications Status of the homes after the earthquake:  37 : have been / to be demolished,  1 :  reparable  5 :  habitable. Temporary housing has been installed “ Los Coipos” village

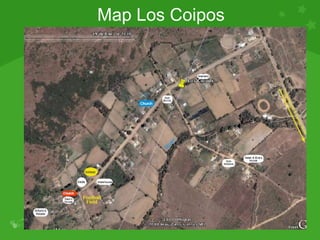

Map Los Coipos

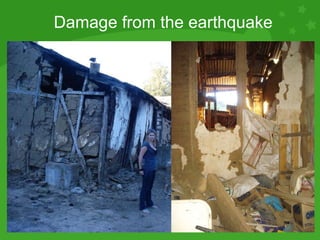

Damage from the earthquake

Volunteer Work & Support Volunteer Group “Levantemos Los Coipos” Borders Exploration Group  Other independent volunteers devoting their free time to help.
Video

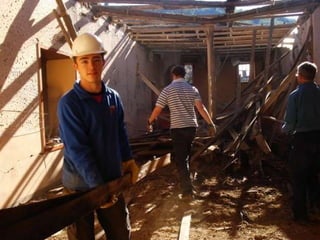

Community Centre: Badly damaged & unuseable as it is dangerous. The community centre is the heart of the community, used by: Old aged pensioners group – weekly meetings Distribution of government subsidiaries to local people Home to medical visits School , Church & Sports club functions Meetings for the neighborhood group  “Junta de Vecinos” All community events Project: Community Centre  (“Sede social”)

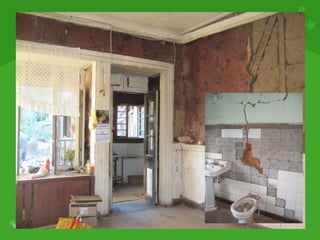

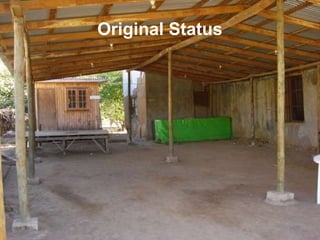

Original Status

Sede Plans

Dimensions

Model

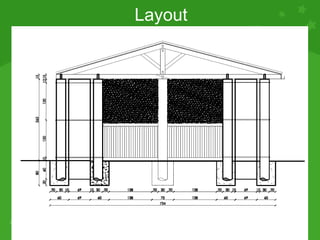

Layout

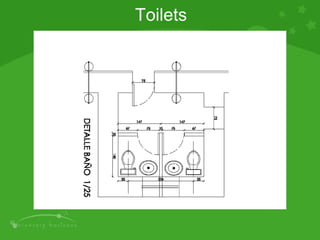

Toilets
Stage 1

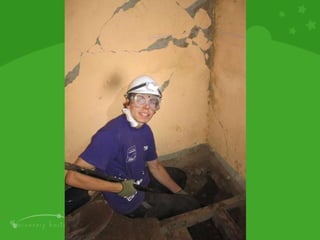

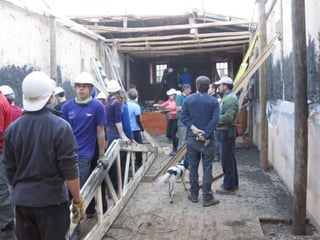

Work to Date Cleaned out the “sede” and organized warehouse where materials are stored. Put supports up on the walls (internally and externally) Removed floor boards, marked out pillars on the sides of the walls and dug out holes for the pillars. Drill holes through walls and pillars. Put pillars up next to the walls and filled holes with stones and cement.

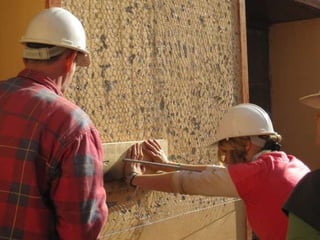

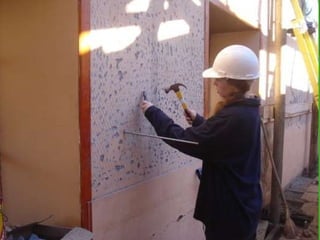

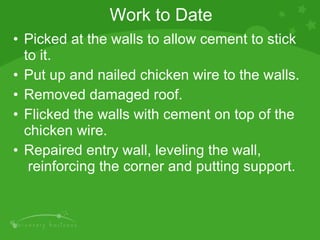

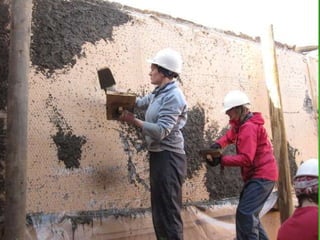

Work to Date Picked at the walls to allow cement to stick to it. Put up and nailed chicken wire to the walls. Removed damaged roof. Flicked the walls with cement on top of the chicken wire. Repaired entry wall, leveling the wall,  reinforcing the corner and putting support.

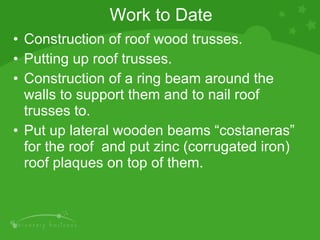

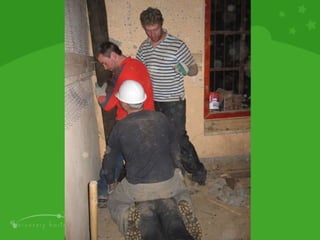

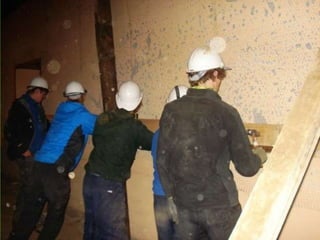

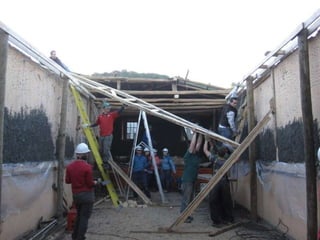

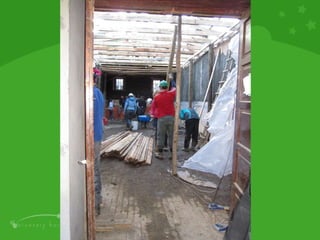

Work to Date Construction of roof wood trusses. Putting up roof trusses. Construction of a ring beam around the walls to support them and to nail roof trusses to. Put up lateral wooden beams “costaneras” for the roof  and put zinc (corrugated iron) roof plaques on top of them.

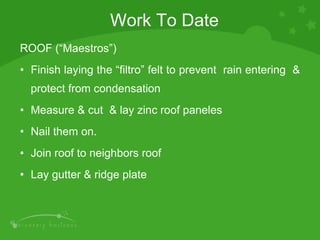

ROOF (“Maestros”) Finish laying the “filtro” felt to prevent  rain entering  & protect from condensation Measure & cut  & lay zinc roof paneles Nail them on. Join roof to neighbors roof Lay gutter & ridge plate Work To Date

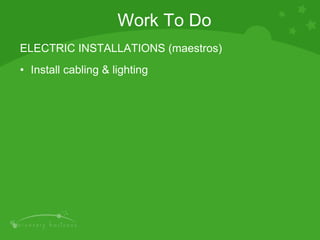

ELECTRIC INSTALLATIONS (maestros) Install cabling & lighting Work To Do

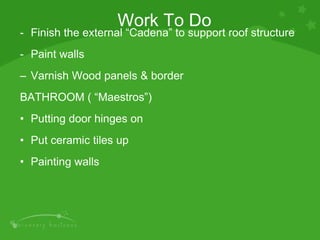

- Finish the external “Cadena” to support roof structure -  Paint walls Varnish Wood panels & border BATHROOM ( “Maestros”) Putting door hinges on Put ceramic tiles up Painting walls Work To Do
Stage 2

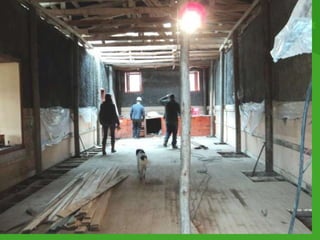

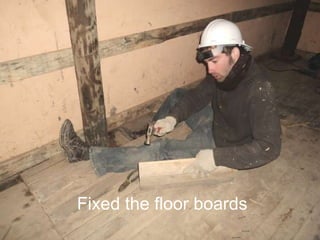

Fixed the floor boards
Finished the roof

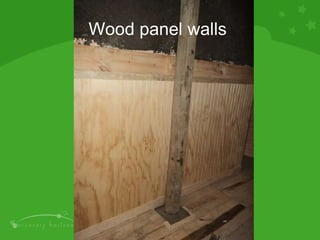

Wood panel walls

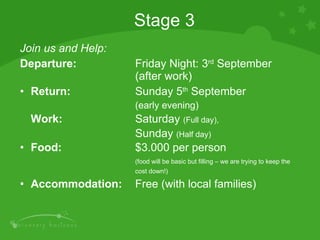

Join us and Help: Departure:  Friday Night: 3 rd  September  (after work) Return:  Sunday 5 th  September  (early evening) Work: Saturday  (Full day),  Sunday  (Half day) Food:  $3.000 per person  (food will be basic but filling – we are trying to keep the  cost down!) Accommodation:   Free (with local families) Stage 3

Los Coipos Community Centre Work to Date

  • 1.
    Rebuilding the CommunityCentre Los Coipos
  • 2.
    Where are we?260 Km. SANTIAGO HUALAÑE VII REGION DEL MAULE
  • 3.
    Population: 250 Number of families: 76 Number of homes : 55 Drinking water Electricity Very limited telecommunications Status of the homes after the earthquake: 37 : have been / to be demolished, 1 : reparable 5 : habitable. Temporary housing has been installed “ Los Coipos” village
  • 4.
  • 5.
    Damage from theearthquake
  • 6.
  • 7.
  • 8.
    Volunteer Work &Support Volunteer Group “Levantemos Los Coipos” Borders Exploration Group Other independent volunteers devoting their free time to help.
  • 9.
  • 10.
    Community Centre: Badlydamaged & unuseable as it is dangerous. The community centre is the heart of the community, used by: Old aged pensioners group – weekly meetings Distribution of government subsidiaries to local people Home to medical visits School , Church & Sports club functions Meetings for the neighborhood group “Junta de Vecinos” All community events Project: Community Centre (“Sede social”)
  • 11.
  • 12.
  • 13.
  • 14.
  • 15.
  • 16.
  • 17.
  • 18.
  • 19.
  • 20.
  • 21.
    Work to DateCleaned out the “sede” and organized warehouse where materials are stored. Put supports up on the walls (internally and externally) Removed floor boards, marked out pillars on the sides of the walls and dug out holes for the pillars. Drill holes through walls and pillars. Put pillars up next to the walls and filled holes with stones and cement.
  • 22.
    Work to DatePicked at the walls to allow cement to stick to it. Put up and nailed chicken wire to the walls. Removed damaged roof. Flicked the walls with cement on top of the chicken wire. Repaired entry wall, leveling the wall,  reinforcing the corner and putting support.
  • 23.
  • 24.
  • 25.
  • 26.
  • 27.
  • 28.
    Work to DateConstruction of roof wood trusses. Putting up roof trusses. Construction of a ring beam around the walls to support them and to nail roof trusses to. Put up lateral wooden beams “costaneras” for the roof  and put zinc (corrugated iron) roof plaques on top of them.
  • 29.
  • 30.
  • 31.
  • 32.
  • 33.
  • 34.
  • 35.
  • 36.
    ROOF (“Maestros”) Finishlaying the “filtro” felt to prevent rain entering & protect from condensation Measure & cut & lay zinc roof paneles Nail them on. Join roof to neighbors roof Lay gutter & ridge plate Work To Date
  • 37.
    ELECTRIC INSTALLATIONS (maestros)Install cabling & lighting Work To Do
  • 38.
    - Finish theexternal “Cadena” to support roof structure - Paint walls Varnish Wood panels & border BATHROOM ( “Maestros”) Putting door hinges on Put ceramic tiles up Painting walls Work To Do
  • 39.
  • 40.
  • 41.
  • 42.
  • 43.
  • 44.
    Join us andHelp: Departure: Friday Night: 3 rd September (after work) Return: Sunday 5 th September (early evening) Work: Saturday (Full day), Sunday (Half day) Food: $3.000 per person (food will be basic but filling – we are trying to keep the cost down!) Accommodation: Free (with local families) Stage 3
