1




Essential Documents for
Effective Teaming
Davis & Steele
NCRC Annual Conference
Putting Together Small Business
Teams to Compete for Larger Contracts
April 18, 2012
2

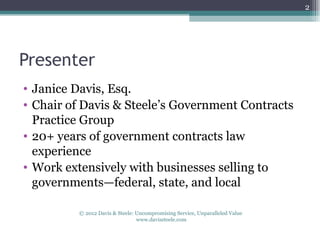

Presenter
• Janice Davis, Esq.
• Chair of Davis & Steele’s Government Contracts
  Practice Group
• 20+ years of government contracts law
  experience
• Work extensively with businesses selling to
  governments—federal, state, and local

         © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                www.davissteele.com

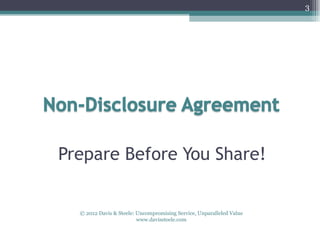

3




Prepare Before You Share!


  © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                         www.davissteele.com
4

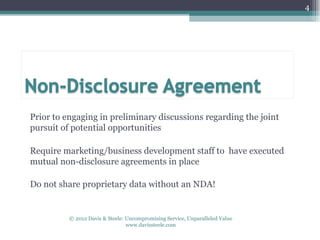

Prior to engaging in preliminary discussions regarding the joint
pursuit of potential opportunities

Require marketing/business development staff to have executed
mutual non-disclosure agreements in place

Do not share proprietary data without an NDA!


          © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                 www.davissteele.com
5




An NDA is a binding agreement that defines proprietary data
and establishes limits on the use of such data by the parties
generally.

An NDA prohibits the disclosure of proprietary data to third
parties, with narrowly defined exceptions.



           © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                  www.davissteele.com
6

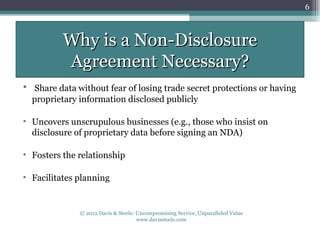

          Why is a Non-Disclosure
          Agreement Necessary?
• Share data without fear of losing trade secret protections or having
  proprietary information disclosed publicly

• Uncovers unscrupulous businesses (e.g., those who insist on
  disclosure of proprietary data before signing an NDA)

• Fosters the relationship

• Facilitates planning


              © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                     www.davissteele.com
7

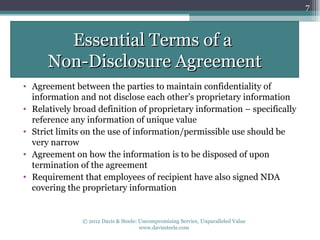

        Essential Terms of a
      Non-Disclosure Agreement
• Agreement between the parties to maintain confidentiality of
  information and not disclose each other’s proprietary information
• Relatively broad definition of proprietary information – specifically
  reference any information of unique value
• Strict limits on the use of information/permissible use should be
  very narrow
• Agreement on how the information is to be disposed of upon
  termination of the agreement
• Requirement that employees of recipient have also signed NDA
  covering the proprietary information


               © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                      www.davissteele.com
8

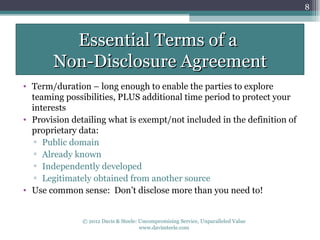

         Essential Terms of a
       Non-Disclosure Agreement
• Term/duration – long enough to enable the parties to explore
  teaming possibilities, PLUS additional time period to protect your
  interests
• Provision detailing what is exempt/not included in the definition of
  proprietary data:
   ▫ Public domain
   ▫ Already known
   ▫ Independently developed
   ▫ Legitimately obtained from another source
• Use common sense: Don’t disclose more than you need to!


               © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                      www.davissteele.com
9

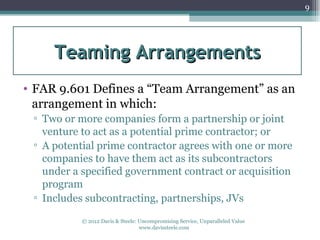

     Teaming Arrangements
• FAR 9.601 Defines a “Team Arrangement” as an
  arrangement in which:
 ▫ Two or more companies form a partnership or joint
   venture to act as a potential prime contractor; or
 ▫ A potential prime contractor agrees with one or more
   companies to have them act as its subcontractors
   under a specified government contract or acquisition
   program
 ▫ Includes subcontracting, partnerships, JVs

           © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                  www.davissteele.com
10

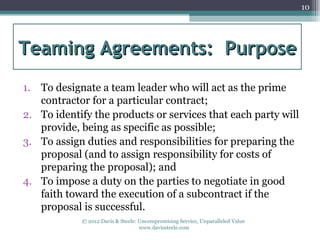

Teaming Agreements: Purpose
1. To designate a team leader who will act as the prime
   contractor for a particular contract;
2. To identify the products or services that each party will
   provide, being as specific as possible;
3. To assign duties and responsibilities for preparing the
   proposal (and to assign responsibility for costs of
   preparing the proposal); and
4. To impose a duty on the parties to negotiate in good
   faith toward the execution of a subcontract if the
   proposal is successful.
            © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                   www.davissteele.com
11



        Teaming Agreements:
           Enforceable?
• Enforceable When Carefully Drafted
• Teaming agreements may or may not be legally binding
  commitments
• If forward looking and general, not likely to be a binding
  commitment
• If detailed with essential provisions, may be a binding
  commitment



            © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                   www.davissteele.com
12

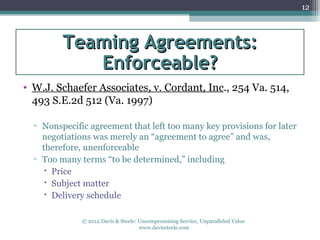

         Teaming Agreements:
            Enforceable?
• W.J. Schaefer Associates, v. Cordant, Inc., 254 Va. 514,
  493 S.E.2d 512 (Va. 1997)

  ▫ Nonspecific agreement that left too many key provisions for later
    negotiations was merely an “agreement to agree” and was,
    therefore, unenforceable
  ▫ Too many terms “to be determined,” including
      Price
      Subject matter
      Delivery schedule

              © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                     www.davissteele.com
13

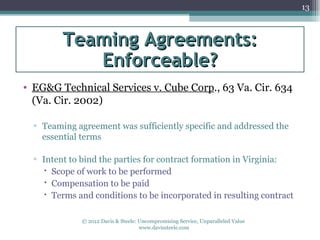

         Teaming Agreements:
            Enforceable?
• EG&G Technical Services v. Cube Corp., 63 Va. Cir. 634
  (Va. Cir. 2002)

  ▫ Teaming agreement was sufficiently specific and addressed the
    essential terms

  ▫ Intent to bind the parties for contract formation in Virginia:
     Scope of work to be performed
     Compensation to be paid
     Terms and conditions to be incorporated in resulting contract

              © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                     www.davissteele.com
14

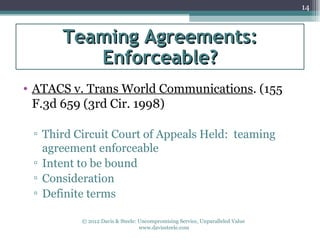

      Teaming Agreements:
         Enforceable?
• ATACS v. Trans World Communications. (155
  F.3d 659 (3rd Cir. 1998)

 ▫ Third Circuit Court of Appeals Held: teaming
   agreement enforceable
 ▫ Intent to be bound
 ▫ Consideration
 ▫ Definite terms

          © 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                                 www.davissteele.com
15

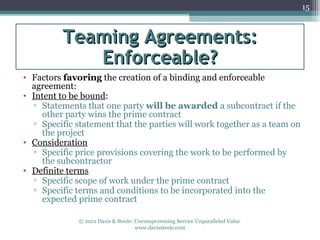

          Teaming Agreements:
             Enforceable?
• Factors favoring the creation of a binding and enforceable
  agreement:
• Intent to be bound:
  ▫ Statements that one party will be awarded a subcontract if the
    other party wins the prime contract
  ▫ Specific statement that the parties will work together as a team on
    the project
• Consideration
  ▫ Specific price provisions covering the work to be performed by
    the subcontractor
• Definite terms
  ▫ Specific scope of work under the prime contract
  ▫ Specific terms and conditions to be incorporated into the
    expected prime contract

              © 2012 Davis & Steele: Uncompromising Service Unparalleled Value
                                     www.davissteele.com
16



          Teaming Agreements:
             Enforceable?
• Factors against the creation of a binding and enforceable
  agreement:
• No intent to be bound:
  ▫ Statement that the team members plan to enter into good faith
    negotiations toward a final subcontract
  ▫ No statement that the team member will be awarded a
    subcontract if the other team member wins the prime contract
• Consideration
  ▫ General statement that team members will seek to agree on
    compensation
• Terms and Conditions
  ▫ General description of scope of work under the prime contract
  ▫ Statement that the parties will be released from their obligations
    if they fail to negotiate a subcontract
  ▫ Lack of detailed terms and conditions
              © 2012 Davis & Steele: Uncompromising Service Unparalleled Value
                                     www.davissteele.com
17




Content of a Teaming Agreement
• Every Teaming Agreement should contain, at a
  minimum:
 1.   the purpose of the agreement;
 2.   whether the agreement is exclusive or non-exclusive
 3.   specific duties of the prime contractor;
 4.   specific duties of the subcontractor;
 5.   specific consideration
 6.   confidential information protection provisions;
 7.   dispute resolution provisions;
 8.   payment terms; and
 9.   a term and termination provision.
           © 2012 Davis & Steele: Uncompromising Service Unparalleled Value
                                  www.davissteele.com
18

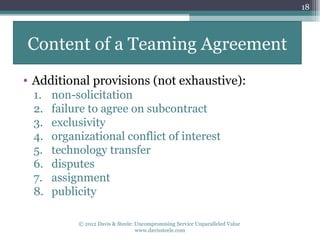

Content of a Teaming Agreement
• Additional provisions (not exhaustive):
 1.   non-solicitation
 2.   failure to agree on subcontract
 3.   exclusivity
 4.   organizational conflict of interest
 5.   technology transfer
 6.   disputes
 7.   assignment
 8.   publicity

           © 2012 Davis & Steele: Uncompromising Service Unparalleled Value
                                  www.davissteele.com
19

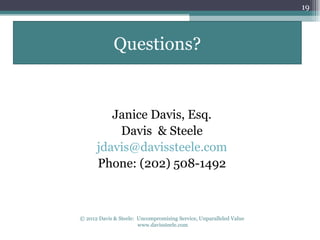

             Questions?


         Janice Davis, Esq.
          Davis & Steele
      jdavis@davissteele.com
      Phone: (202) 508-1492



© 2012 Davis & Steele: Uncompromising Service, Unparalleled Value
                       www.davissteele.com

Janice Davis | Putting Together Small Business Teams
