IT 328 Final Project Guidelines and Rubric
Overview
The final project for this course is the creation of a risk analysis
and mitigation memo.
We all work on projects whether at work, at school, or around
the house. Some projects are small and can be completed
quickly; however, some take time,
planning, and preparation. How can you make sure that a project
is completed once it is started? How do projects in information
technology really run behind
the scenes? Project management provides a structured method to
move through a project from the time it is created until the time
it is completed and all the
steps in between.
In this project, imagine that you are team member for an IT
development project. Your team has identified several risks the
project faces that could negatively
impact its outcome. You have been tasked with selecting one of
those risks and analyzing it in order to determine the best
solution to mitigate the risk and
determine how your solution will affect the overall project. You
will write a professional email memo to your project manager,
with supporting documentation
as attachments. The email will explain your analysis,
recommendations, and the impact of those recommendations.
Your thorough analysis is critical to the
project manager to help him or her make an informed decision
about how to move the project forward. Use this reference as an
example, to assist you with
writing a business memo.
In this assignment, you will demonstrate your mastery of the
following course outcomes:
project’s scope, budget, and schedule to determine how they
impact one another
-appropriate messaging for communicating
an information technology project’s status and needs to project
stakeholders
-technology considerations for
informing project risk-management response strategies
Examine project management documents for key project data
to promote successful information technology projects through
development, testing, and
production
Prompt
Your email memo and attachments should be drafted in a Word
document with the project charter, RACI chart, and Gantt charts
included in an appendix. In
your memo, you will describe background information about the
project that you are working on, detail information about a
specific project risk, and propose a
recommended risk mitigation strategy to your leadership team.
Your memo will make use of the following project scenario:
https://owl.purdue.edu/owl/subject_specific_writing/professiona
l_technical_writing/memos/sample_memo.html
Regatta University is a leader in both traditional education and
career-path development, including in emerging fields. The
university prides itself on staying on
the leading edge of curriculum and degree programs, learning
methodologies and instructional technologies, student services,
and demonstrated student
success. “The future is here and now,” the university’s
president, Martha Yoon, likes to say.
Regatta serves approximately 8,000 students at locations
including the original campus in Augusta, Maine, and satellite
campuses in Ventura, California; Dayton,
Ohio; and Hilo, Hawaii. In a typical term, approximately 40%
of Regatta’s students take courses at a distance through the
university’s online education hub.
Enrollment growth has been strong, increasing by 4 to 8% each
year for the last decade.

You are a key member of the information technology team at
Regatta, with a core specialization in student services. You are
responsible for providing user-
friendly interfaces connecting to a flexible, powerful
information structure. Now you have a new project—working
with colleagues to create a student degree
progress tool that students will use for accurate, instant
information on their progress toward program and degree
completion. As you may imagine, this tool is
eagerly awaited by a variety of stakeholders, including Regatta
academic advisors and the Office of Enrollment Management, as
tracking and communicating
student progress toward degree completion is vital for retention.
“We need a tool that will be easy to use but also accurate. No
misinformation!” your team
manager says.
Your memo will analyze and recommend mitigation strategies
for one project risk. The risk you choose to focus on must come
from the list of project risks in
the provided Project Management Documents Excel worksheet.
They are located in the tab titled Risk Matrix.
Specifically, the following critical elements must be addressed
in your memo:

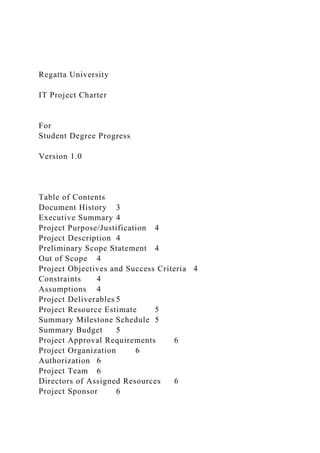

I. Introduction: Using the Student Degree Progress Project
Charter document, the RACI chart in the Project Management
Documents workbook, and the

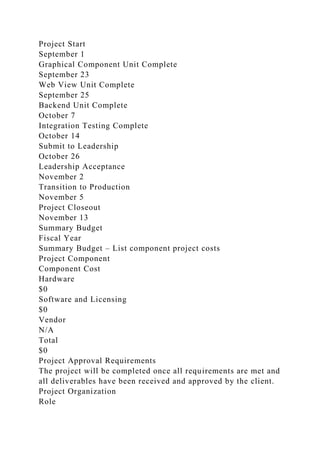

Gantt Chart document as guides, provide background
information on the project you are working on.
A. Describe the purpose of the project and the end objective,
including where this information is documented.

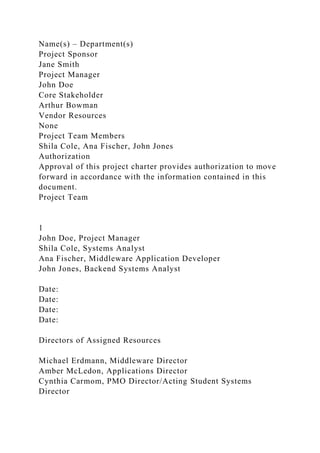

B. Identify the key stakeholders involved in the project,
including an explanation of their roles and responsibilities.
C. Describe your own role and responsibilities on the project
team, citing specific information from the project’s Gantt chart.

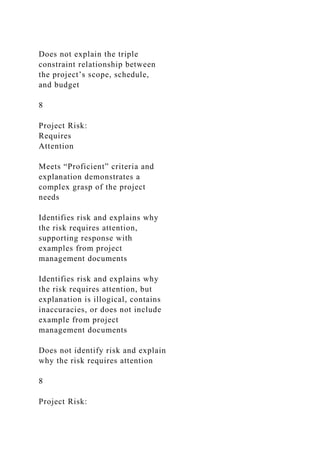

D. Explain the triple constraint relationship between the
project’s scope, schedule, and budget. Support your response
with examples from the
project materials and your experience in adding the new element
to your project during Milestone Two.
II. Project Risk: Select a risk from the list in the Project
Management Documents workbook. Using these project
management documents as guides,
provide detailed information about the specific project risk.
A. Explain why this risk requires attention. Support your
response with examples from the project management
documents.

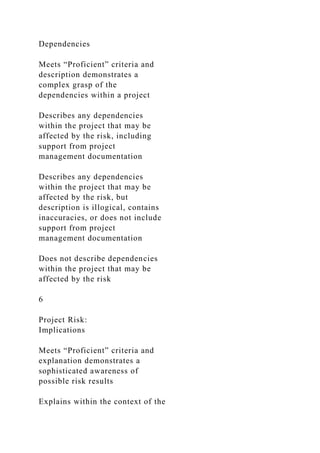

B. Describe any dependencies within the project that may be
affected by this risk. Provide specific examples from the project
management
documentation to support your response.
C. Explain the implications for the project within the context of

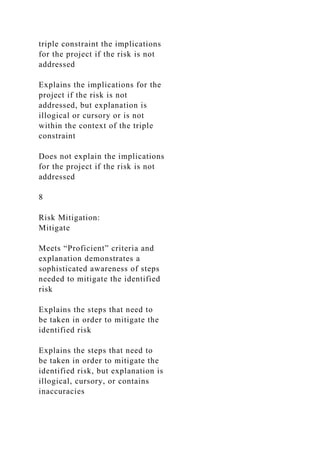

the triple constraint if this risk is not addressed.
http://snhu-
media.snhu.edu/files/course_repository/undergraduate/it/it328/it
328_student_degree_progress_project_charter.docx
http://snhu-
media.snhu.edu/files/course_repository/undergraduate/it/it328/it
328_project_management_documents.xlsx
http://snhu-
media.snhu.edu/files/course_repository/undergraduate/it/it328/it
328_gantt_chart.mpp
III. Risk Mitigation: Using all available project documents as
guides, recommend a risk mitigation strategy.
A. Explain the steps that need to be taken in order to mitigate
the identified risk.
B. Explain in detail how the proposed mitigation strategy will
affect the project. Include any tradeoffs that must be made to
accommodate the
mitigation strategy, and consider the triple constraint and any
other variables that you deem important.
C. Defend why your proposed mitigation strategy is the best
course of action for the project team.
IV. Conclusion: Summarize the project needs in your project
risk and mitigation proposal for your stakeholders. What are the
most important pieces of
information to take away?
V. Communication: Your risk mitigation email memo
attachments will be evaluated based on the following elements:
A. Develop email communication in a clear and professional
way, using language appropriate for the audience of
stakeholders.
B. Attach supporting documentation to aid in the
communication of your mitigation strategy.
Milestones

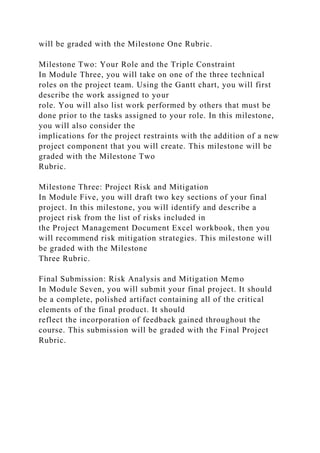

Milestone One: Introduction, Stakeholders, and Roles
In Module Two, you will compose a brief project description
that summarizes the student degree progress project, including
its purposes, objectives, and how
and where to find further information about it. This milestone
will be graded with the Milestone One Rubric.
Milestone Two: Your Role and the Triple Constraint
In Module Three, you will take on one of the three technical
roles on the project team. Using the Gantt chart, you will first
describe the work assigned to your
role. You will also list work performed by others that must be
done prior to the tasks assigned to your role. In this milestone,
you will also consider the
implications for the project restraints with the addition of a new
project component that you will create. This milestone will be
graded with the Milestone Two
Rubric.
Milestone Three: Project Risk and Mitigation
In Module Five, you will draft two key sections of your final
project. In this milestone, you will identify and describe a
project risk from the list of risks included in
the Project Management Document Excel workbook, then you
will recommend risk mitigation strategies. This milestone will
be graded with the Milestone
Three Rubric.
Final Submission: Risk Analysis and Mitigation Memo
In Module Seven, you will submit your final project. It should
be a complete, polished artifact containing all of the critical
elements of the final product. It should
reflect the incorporation of feedback gained throughout the
course. This submission will be graded with the Final Project
Rubric.
Deliverables
Milestone Deliverable Module Due Grading
One Introduction, Stakeholders, and Roles 2 Graded separately;
Milestone One Rubric
Two Your Role and the Triple Constraint 3 Graded separately;
Milestone Two Rubric
Three Project Risk and Mitigation 5 Graded separately;
Milestone Three Rubric
Final Submission: Risk Analysis and
Mitigation Memo
7 Graded separately; Final Project Rubric
Final Project Rubric
Guidelines for Submission: Your email memo and attachments
should be 2 to 4 pages in length with double spacing, one-inch
margins, 12-point Times New
Roman font, and adherence to the latest edition of APA
formatting.
Critical Elements Exemplary (100%) Proficient (85%) Needs
Improvement (55%) Not Evident (0%) Value
Introduction:
Purpose
Meets “Proficient” criteria and
description demonstrates an
advanced ability to extract
accurate information from
project documentation

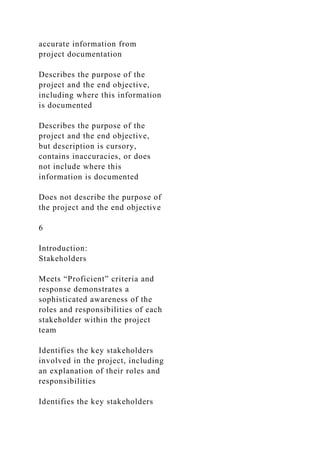

Describes the purpose of the
project and the end objective,
including where this information
is documented
Describes the purpose of the
project and the end objective,
but description is cursory,
contains inaccuracies, or does
not include where this
information is documented
Does not describe the purpose of
the project and the end objective
6

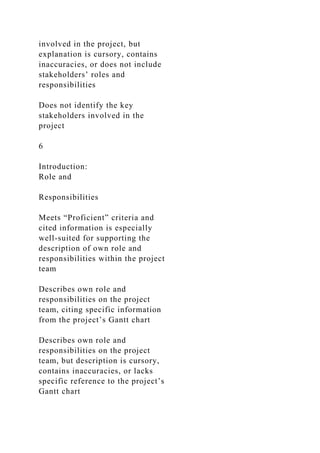

Introduction:
Stakeholders
Meets “Proficient” criteria and
response demonstrates a
sophisticated awareness of the
roles and responsibilities of each
stakeholder within the project
team
Identifies the key stakeholders
involved in the project, including
an explanation of their roles and
responsibilities
Identifies the key stakeholders
involved in the project, but
explanation is cursory, contains
inaccuracies, or does not include
stakeholders’ roles and
responsibilities
Does not identify the key
stakeholders involved in the
project
6
Introduction:
Role and
Responsibilities
Meets “Proficient” criteria and
cited information is especially
well-suited for supporting the
description of own role and
responsibilities within the project
team
Describes own role and
responsibilities on the project
team, citing specific information
from the project’s Gantt chart
Describes own role and
responsibilities on the project
team, but description is cursory,
contains inaccuracies, or lacks
specific reference to the project’s
Gantt chart
Does not describe own role and
responsibilities on the project
team or cite specific information
from the project’s Gantt chart
6
Introduction:
Triple Constraint
Meets “Proficient” criteria and
explanation demonstrates a
complex grasp of the implications
of the triple constraint
relationship on the project
Explains the triple constraint
relationship between the
project’s scope, schedule, and
budget, supporting response
with examples from the project
materials and experience in this
course
Explains the triple constraint
relationship between the
project’s scope, schedule, and
budget, but explanation is
illogical, contains inaccuracies, or
is not supported by examples
from the project materials and
experience in this course
Does not explain the triple
constraint relationship between
the project’s scope, schedule,
and budget
8
Project Risk:
Requires
Attention
Meets “Proficient” criteria and
explanation demonstrates a
complex grasp of the project
needs
Identifies risk and explains why
the risk requires attention,
supporting response with
examples from project
management documents
Identifies risk and explains why
the risk requires attention, but
explanation is illogical, contains
inaccuracies, or does not include
example from project
management documents
Does not identify risk and explain
why the risk requires attention
8
Project Risk:
Dependencies
Meets “Proficient” criteria and
description demonstrates a
complex grasp of the
dependencies within a project
Describes any dependencies
within the project that may be
affected by the risk, including
support from project
management documentation
Describes any dependencies
within the project that may be
affected by the risk, but
description is illogical, contains
inaccuracies, or does not include
support from project
management documentation
Does not describe dependencies
within the project that may be
affected by the risk
6
Project Risk:
Implications
Meets “Proficient” criteria and
explanation demonstrates a
sophisticated awareness of
possible risk results
Explains within the context of the
triple constraint the implications
for the project if the risk is not
addressed
Explains the implications for the
project if the risk is not
addressed, but explanation is
illogical or cursory or is not
within the context of the triple
constraint
Does not explain the implications
for the project if the risk is not
addressed
8
Risk Mitigation:
Mitigate
Meets “Proficient” criteria and
explanation demonstrates a
sophisticated awareness of steps
needed to mitigate the identified
risk
Explains the steps that need to
be taken in order to mitigate the
identified risk
Explains the steps that need to
be taken in order to mitigate the
identified risk, but explanation is
illogical, cursory, or contains
inaccuracies
Does not explain the steps that
need to be taken in order to
mitigate the identified risk
8
Risk Mitigation:
Affect
Meets “Proficient” criteria and
explanation makes cogent
connections between important
project variables and the
proposed risk mitigation strategy
Explains in detail how the
proposed mitigation strategy will
affect the project, considering
the triple constraint and any
other variables deemed
important including any tradeoffs
that must be made to
accommodate the mitigation
strategy
Explains how the proposed
mitigation strategy will affect the
project, but explanation lacks
detail, is illogical, contains
inaccuracies, does not consider
the triple constraint and any
other variables deemed
important, or does not include
tradeoffs that must be made to
accommodate the mitigation
strategy
Does not explain how the
proposed mitigation strategy will
affect the project
8
Risk Mitigation:
Best Course of
Action
Meets “Proficient” criteria and
defense makes cogent
connections between the
proposed mitigation strategy and
the project goals
Defends why the proposed
mitigation strategy is the best
course of action for the project
team
Defends why the proposed
mitigation strategy is the best
course of action for the project
team, but response is cursory or
illogical or contains inaccuracies
Does not defend why the
proposed mitigation strategy is
the best course of action for the
project team
8
Conclusion Meets “Proficient” criteria and
summary demonstrates an
advanced ability to distill project
information
Summarizes the project needs for
stakeholders
Summarizes the needs for
stakeholders, but summary is
unclear or missing key
components
Does not summarize the project
needs for stakeholders
8
Communication:
Professional
Meets “Proficient” criteria and
email demonstrates an advanced
ability to appropriately tailor
communication to a specified
audience
Develops email communication
in a clear and professional
manner, using language
appropriate for the audience of
stakeholders
Develops email communication
in a professional manner, but
language is not appropriate for
the audience of stakeholders or
information is not clear
Does not develop email in a clear
and professional manner using
language appropriate for the
audience of stakeholders
8
Communication:
Documentation
Meets “Proficient” criteria and
supporting documentation is
especially well-suited to aid in
the communication of the
proposed mitigation strategy
Attaches supporting
documentation to aid in the
communication of the mitigation
strategy
Attaches supporting
documentation to aid in the
communication of the mitigation
strategy, but documentation is
incomplete or contains
inaccuracies
Does not attach supporting
documentation to aid in the
communication of the mitigation
strategy
8
Articulation of
Response
Submission is free of errors
related to citations, grammar,
spelling, syntax, and organization
Submission has no major errors
related to citations, grammar,
spelling, syntax, or organization
Submission has major errors
related to citations, grammar,
spelling, syntax, or organization
that negatively impact readability
and articulation of main ideas
Submission has critical errors
related to citations, grammar,
spelling, syntax, or organization
that prevent understanding of
ideas
4
Total 100%
Regatta University
IT Project Charter
For
Student Degree Progress
Version 1.0
Table of Contents
Document History 3
Executive Summary 4
Project Purpose/Justification 4
Project Description 4
Preliminary Scope Statement 4
Out of Scope 4
Project Objectives and Success Criteria 4
Constraints 4
Assumptions 4
Project Deliverables 5
Project Resource Estimate 5
Summary Milestone Schedule 5
Summary Budget 5
Project Approval Requirements 6
Project Organization 6
Authorization 6
Project Team 6
Directors of Assigned Resources 6
Project Sponsor 6
Document History
Document Revision/Release Status
Revision
Date
Description of Changes
Author / Editor
0.1
6/29/15
Initial format
Jane Smith
1.0
8/31/15
Initial draft
John Doe
Executive Summary
Students leverage a web portal to access university-related
information and resources. Content within it can be targeted to
all users or to those within a pre-specified role (e.g., students at
a particular campus) or it can be user-specific.
As an academic institution, one piece of information critical to
students is their current progress in their degree program or
programs.
The purpose of the student degree progress project is to create
an area to display user-specific academic progress.
Project Purpose/Justification
University leadership requested this project to promote student
awareness and provide students easy access to their degree
progress.
Project DescriptionPreliminary Scope Statement
The purpose of this project is to create an area that displays
user-specific academic progress within the appropriate roles,
leveraging data through a back-end system. This project will
include the necessary modifications to the back end to relay this
information. More specifically, this project will include the
following:
· Creating the graphical elements in a web-friendly format
· Creating the necessary web view to accommodate the
graphical elements
· Creating the necessary changes to the back end to prepare data
supporting the student information
· Creating the necessary web service to securely expose the
student’s information to the graphical elements and web view
Out of Scope
Due to business-specific processes, some students, particularly
those who have been pursuing a degree for over four years, may
not be able to see their academic progress using the deliverables
of this project. Changes to the back end to expand this
functionality are out of scope, as are any changes intended to
enhance functionality to provide additional data beyond the
academic progress already captured in another system.
Project Objectives and Success Criteria
· The project will provide the functionality described within the
preliminary scope statement.
· The project will be delivered without incurring any additional
expenses.
· The project will be delivered free from any significant defects
or without causing any down time.
· The project will be delivered no later than two weeks from the
target time frame defined within the milestone schedule below.
Constraints
· Additional funding is not available.
· The information available to students is derived from data
within the back end and is as accurate, timely, and available as
the source data and its structuring.
Assumptions
· No major changes in formatting or scope will be presented
during the life of the project.Project Deliverables
· Project Charter
· Project Management Plan
· Design
· User Interface Mockup
· Architectural Design
· Test Plan
· Test Scenarios
Project Resource Estimate
The student degree progress project is estimated to use the
following resources:
Project Resource Estimate
Resource
Estimated Work Hours
Project Manager
48 Hours
Systems Analyst
12 Hours
Middleware Applications Developer
44 Hours
Backend Systems Analyst
50 Hours
Total:
154 Hours
Summary Milestone Schedule
Summary Milestone Schedule – List key project milestones
relative to project start
Project Milestone
Target Date
Project Start
September 1
Graphical Component Unit Complete
September 23
Web View Unit Complete
September 25
Backend Unit Complete
October 7
Integration Testing Complete
October 14
Submit to Leadership
October 26
Leadership Acceptance
November 2
Transition to Production
November 5
Project Closeout
November 13
Summary Budget
Fiscal Year
Summary Budget – List component project costs
Project Component
Component Cost
Hardware
$0
Software and Licensing
$0
Vendor
N/A
Total
$0
Project Approval Requirements
The project will be completed once all requirements are met and
all deliverables have been received and approved by the client.
Project Organization
Role
Name(s) – Department(s)
Project Sponsor
Jane Smith
Project Manager
John Doe
Core Stakeholder
Arthur Bowman
Vendor Resources
None
Project Team Members
Shila Cole, Ana Fischer, John Jones
Authorization
Approval of this project charter provides authorization to move
forward in accordance with the information contained in this
document.
Project Team
1
John Doe, Project Manager
Shila Cole, Systems Analyst
Ana Fischer, Middleware Application Developer
John Jones, Backend Systems Analyst
Date:
Date:
Date:
Date:
Directors of Assigned Resources
Michael Erdmann, Middleware Director
Amber McLedon, Applications Director
Cynthia Carmom, PMO Director/Acting Student Systems
Director
Date:
Date:
Date:
Project Sponsor
Jane Smith, Project Sponsor
Date:
Project Scenario
Project Scenario
Regatta University is a leader in both traditional education and
career-path development, including in emerging fields. The
university prides itself on staying on the leading edge of
curriculum and degree programs, learning methodologies and
instructional technologies, student services, and demonstrated
student success. “The future is here and now,” the university’s
president, Martha Yoon, likes to say.
Regatta serves approximately 8,000 students at locations
including the original campus in Augusta, Maine, and satellite
campuses in Ventura, California; Dayton, Ohio; and Hilo,
Hawaii. In a typical term, approximately 40% of Regatta’s
students take courses at a distance through the university’s
online education hub. Enrollment growth has been strong,
increasing by 4 to 8% each year for the last decade.
You are a key member of the information technology team at
Regatta, with a core specialization in student services. You are
responsible for providing user-friendly interfaces connecting to
a flexible, powerful information structure. Now you have a new
project—working with colleagues to create a student degree
progress tool that students will use for accurate, instant
information on their progress toward program and degree
completion. As you may imagine, this tool is eagerly awaited by
a variety of stakeholders, including Regatta academic advisors
and the Office of Enrollment Management, as tracking and
communicating student progress toward degree completion is
vital for retention. “We need a tool that will be easy to use but
also accurate. No misinformation!” your team manager says.
RACI ChartSteps will be highlighted if A and R are not
assigned.R:Does the step RACI ChartA:Accountable for the
stepC:Consulted with before the stepI:Informed when the step is
completedProject:Student Degree
ProgressDEPARTMENTInformation
TechnologySTEPDESCRIPTIONJane SmithJohn DoeArthur
BowmanShila ColeAna FischerJohn Jones1Create the project
charterIA/R2Develop the project management planA/R3Define
the project scopeA/RCC/III4Create a formal budget and budget
planC/IA/RI5Fill in a Gantt chart with the project schedule and
milestonesIA/RIC/III6Develop a user interface mockup for
reviewA/R7Create the architectural design for the front end of
the application (user-facing)A/R8Create the architectural design
for the back end of the application (for data
processing)A/R9Develop the graphic user interface (GUI) for
the degree trackerA/R10Develop the web code to receive data
from the back end and place data within the GUIA/R11Develop
the back-end code to process data and send it to the web
applicationA/R12Create a defined test plan for all system
componentsA/RC/IC/I13Test the scenarios defined in the test
plan for proper application behaviorA/RRR14Perform
integration testing to ensure that the front-end components and
back-end components speak to each other as well as integrate
seamlessly with the rest of the web
applicationIA/RRR15Transition web application into production
environment (go-live)C/IA/RA/R16Monitor project progress
throughout its life cycleA/RI17Manage project deliverables for
records and hand-offA/RI18Assess and manage risks throughout
the project life cycleA/RRRR19Develop the final project
reportIA/RI20Perform project reflectionsA/RCCC
Work Breakdown Structure (WBS)
1.0 Student Degree Progress Project
1.1 Initiation
1.1.2 Project Management Plan
1.2 Planning
1.3.1.1 User Interface Mockup
1.3.1.2 Architectural Design - Main Application
1.3.2 Implementation
1.3.3.2 Test Scenarios
1.3.3.3 Integration Testing
1.3.4 Transition to Production
1.5 Project Closeout
1.3.3 Testing
1.3.3.1 Test Plan
1.3.2.1 Graphical Component Unit
1.3.2.2 Web View Unit
1.3.2.3 Backend Unit
1.1.1 Project Charter
1.3 Execution
1.2.1 Scope Definition
1.2.3 Scheduling (Gantt Chart)
1.3.1 Design
1.2.2 Budget Plan
1.4.1 Final Project Report
1.4.2 Project Reflections (Lessons Learned)

1.4 Controlling
1.4.1 Monitor Project Progress
1.4.2 Manage Deliverables
1.4.3 Assess and Manage Risks
1.3.1.3 Architectural Design - Backend
Risk MatrixProject Risk LikelihoodImplicationsThere is a risk
that severe weather in Sailcloth, Maine (the main campus that
houses the development team), will close the campus and impact
progress.MediumThere is a risk that the ambiguity in the project
scope (it only defines "graphical element" but not what type)
will lead to requirement changes by the stakeholder during
development, affecting both the budget and schedule.HighThere
is a risk that sign-off on project deliverables (charter, Gantt
chart, product approval, etc.) from project sponsors and
stakeholders exceeds the allotted time. This decision delay will
impact the progress schedule.LowThere is a risk for rollout
issues when deploying to production due to complexity of
merging code with the "go-live" of another project on the same
system.HighTwo projects are currently being developed at the
same time in the same code base. Delays to the secondary
project will cause delays to the Student Progress go-
live.HighThe student portal where the project will be deployed
is a high-availability system and is expected to be accessible for
students 24/7. There is a risk that the large number of changes
occurring during go-live could take the system offline,
temporarily impacting system availability. LowThere is a risk
that an interpersonal conflict will arise within the team,
impacting the human resources assigned to the project and
potentially impacting the allotted schedule.Low
Team Member InfoRoleNameRole DescriptionJane SmithJohn
DoeArthur BowmanShila ColeAna FischerJohn Jones

IT 328 Final Project Guidelines and Rubric Overview.docx

  • 1.
    IT 328 FinalProject Guidelines and Rubric Overview The final project for this course is the creation of a risk analysis and mitigation memo. We all work on projects whether at work, at school, or around the house. Some projects are small and can be completed quickly; however, some take time, planning, and preparation. How can you make sure that a project is completed once it is started? How do projects in information technology really run behind the scenes? Project management provides a structured method to move through a project from the time it is created until the time it is completed and all the steps in between. In this project, imagine that you are team member for an IT development project. Your team has identified several risks the project faces that could negatively impact its outcome. You have been tasked with selecting one of those risks and analyzing it in order to determine the best solution to mitigate the risk and determine how your solution will affect the overall project. You will write a professional email memo to your project manager, with supporting documentation as attachments. The email will explain your analysis, recommendations, and the impact of those recommendations.
  • 2.
    Your thorough analysisis critical to the project manager to help him or her make an informed decision about how to move the project forward. Use this reference as an example, to assist you with writing a business memo. In this assignment, you will demonstrate your mastery of the following course outcomes: project’s scope, budget, and schedule to determine how they impact one another -appropriate messaging for communicating an information technology project’s status and needs to project stakeholders -technology considerations for informing project risk-management response strategies Examine project management documents for key project data to promote successful information technology projects through development, testing, and production Prompt Your email memo and attachments should be drafted in a Word document with the project charter, RACI chart, and Gantt charts included in an appendix. In your memo, you will describe background information about the project that you are working on, detail information about a specific project risk, and propose a recommended risk mitigation strategy to your leadership team.
  • 3.
    Your memo willmake use of the following project scenario: https://owl.purdue.edu/owl/subject_specific_writing/professiona l_technical_writing/memos/sample_memo.html Regatta University is a leader in both traditional education and career-path development, including in emerging fields. The university prides itself on staying on the leading edge of curriculum and degree programs, learning methodologies and instructional technologies, student services, and demonstrated student success. “The future is here and now,” the university’s president, Martha Yoon, likes to say. Regatta serves approximately 8,000 students at locations including the original campus in Augusta, Maine, and satellite campuses in Ventura, California; Dayton, Ohio; and Hilo, Hawaii. In a typical term, approximately 40% of Regatta’s students take courses at a distance through the university’s online education hub. Enrollment growth has been strong, increasing by 4 to 8% each year for the last decade. You are a key member of the information technology team at Regatta, with a core specialization in student services. You are responsible for providing user- friendly interfaces connecting to a flexible, powerful information structure. Now you have a new project—working with colleagues to create a student degree
  • 4.
    progress tool thatstudents will use for accurate, instant information on their progress toward program and degree completion. As you may imagine, this tool is eagerly awaited by a variety of stakeholders, including Regatta academic advisors and the Office of Enrollment Management, as tracking and communicating student progress toward degree completion is vital for retention. “We need a tool that will be easy to use but also accurate. No misinformation!” your team manager says. Your memo will analyze and recommend mitigation strategies for one project risk. The risk you choose to focus on must come from the list of project risks in the provided Project Management Documents Excel worksheet. They are located in the tab titled Risk Matrix. Specifically, the following critical elements must be addressed in your memo: I. Introduction: Using the Student Degree Progress Project Charter document, the RACI chart in the Project Management Documents workbook, and the Gantt Chart document as guides, provide background information on the project you are working on. A. Describe the purpose of the project and the end objective, including where this information is documented. B. Identify the key stakeholders involved in the project, including an explanation of their roles and responsibilities. C. Describe your own role and responsibilities on the project team, citing specific information from the project’s Gantt chart. D. Explain the triple constraint relationship between the
  • 5.
    project’s scope, schedule,and budget. Support your response with examples from the project materials and your experience in adding the new element to your project during Milestone Two. II. Project Risk: Select a risk from the list in the Project Management Documents workbook. Using these project management documents as guides, provide detailed information about the specific project risk. A. Explain why this risk requires attention. Support your response with examples from the project management documents. B. Describe any dependencies within the project that may be affected by this risk. Provide specific examples from the project management documentation to support your response. C. Explain the implications for the project within the context of the triple constraint if this risk is not addressed. http://snhu- media.snhu.edu/files/course_repository/undergraduate/it/it328/it 328_student_degree_progress_project_charter.docx http://snhu- media.snhu.edu/files/course_repository/undergraduate/it/it328/it 328_project_management_documents.xlsx http://snhu- media.snhu.edu/files/course_repository/undergraduate/it/it328/it 328_gantt_chart.mpp
  • 6.
    III. Risk Mitigation:Using all available project documents as guides, recommend a risk mitigation strategy. A. Explain the steps that need to be taken in order to mitigate the identified risk. B. Explain in detail how the proposed mitigation strategy will affect the project. Include any tradeoffs that must be made to accommodate the mitigation strategy, and consider the triple constraint and any other variables that you deem important. C. Defend why your proposed mitigation strategy is the best course of action for the project team. IV. Conclusion: Summarize the project needs in your project risk and mitigation proposal for your stakeholders. What are the most important pieces of information to take away? V. Communication: Your risk mitigation email memo attachments will be evaluated based on the following elements: A. Develop email communication in a clear and professional way, using language appropriate for the audience of stakeholders. B. Attach supporting documentation to aid in the communication of your mitigation strategy. Milestones Milestone One: Introduction, Stakeholders, and Roles In Module Two, you will compose a brief project description that summarizes the student degree progress project, including its purposes, objectives, and how and where to find further information about it. This milestone
  • 7.
    will be gradedwith the Milestone One Rubric. Milestone Two: Your Role and the Triple Constraint In Module Three, you will take on one of the three technical roles on the project team. Using the Gantt chart, you will first describe the work assigned to your role. You will also list work performed by others that must be done prior to the tasks assigned to your role. In this milestone, you will also consider the implications for the project restraints with the addition of a new project component that you will create. This milestone will be graded with the Milestone Two Rubric. Milestone Three: Project Risk and Mitigation In Module Five, you will draft two key sections of your final project. In this milestone, you will identify and describe a project risk from the list of risks included in the Project Management Document Excel workbook, then you will recommend risk mitigation strategies. This milestone will be graded with the Milestone Three Rubric. Final Submission: Risk Analysis and Mitigation Memo In Module Seven, you will submit your final project. It should be a complete, polished artifact containing all of the critical elements of the final product. It should reflect the incorporation of feedback gained throughout the course. This submission will be graded with the Final Project Rubric.
  • 8.
    Deliverables Milestone Deliverable ModuleDue Grading One Introduction, Stakeholders, and Roles 2 Graded separately; Milestone One Rubric Two Your Role and the Triple Constraint 3 Graded separately; Milestone Two Rubric Three Project Risk and Mitigation 5 Graded separately; Milestone Three Rubric Final Submission: Risk Analysis and Mitigation Memo 7 Graded separately; Final Project Rubric Final Project Rubric Guidelines for Submission: Your email memo and attachments should be 2 to 4 pages in length with double spacing, one-inch margins, 12-point Times New Roman font, and adherence to the latest edition of APA formatting. Critical Elements Exemplary (100%) Proficient (85%) Needs Improvement (55%) Not Evident (0%) Value Introduction: Purpose Meets “Proficient” criteria and description demonstrates an advanced ability to extract
  • 9.
    accurate information from projectdocumentation Describes the purpose of the project and the end objective, including where this information is documented Describes the purpose of the project and the end objective, but description is cursory, contains inaccuracies, or does not include where this information is documented Does not describe the purpose of the project and the end objective 6 Introduction: Stakeholders Meets “Proficient” criteria and response demonstrates a sophisticated awareness of the roles and responsibilities of each stakeholder within the project team Identifies the key stakeholders involved in the project, including an explanation of their roles and responsibilities Identifies the key stakeholders
  • 10.
    involved in theproject, but explanation is cursory, contains inaccuracies, or does not include stakeholders’ roles and responsibilities Does not identify the key stakeholders involved in the project 6 Introduction: Role and Responsibilities Meets “Proficient” criteria and cited information is especially well-suited for supporting the description of own role and responsibilities within the project team Describes own role and responsibilities on the project team, citing specific information from the project’s Gantt chart Describes own role and responsibilities on the project team, but description is cursory, contains inaccuracies, or lacks specific reference to the project’s Gantt chart
  • 11.
    Does not describeown role and responsibilities on the project team or cite specific information from the project’s Gantt chart 6 Introduction: Triple Constraint Meets “Proficient” criteria and explanation demonstrates a complex grasp of the implications of the triple constraint relationship on the project Explains the triple constraint relationship between the project’s scope, schedule, and budget, supporting response with examples from the project materials and experience in this course Explains the triple constraint relationship between the project’s scope, schedule, and budget, but explanation is illogical, contains inaccuracies, or is not supported by examples from the project materials and experience in this course
  • 12.
    Does not explainthe triple constraint relationship between the project’s scope, schedule, and budget 8 Project Risk: Requires Attention Meets “Proficient” criteria and explanation demonstrates a complex grasp of the project needs Identifies risk and explains why the risk requires attention, supporting response with examples from project management documents Identifies risk and explains why the risk requires attention, but explanation is illogical, contains inaccuracies, or does not include example from project management documents Does not identify risk and explain why the risk requires attention 8 Project Risk:
  • 13.
    Dependencies Meets “Proficient” criteriaand description demonstrates a complex grasp of the dependencies within a project Describes any dependencies within the project that may be affected by the risk, including support from project management documentation Describes any dependencies within the project that may be affected by the risk, but description is illogical, contains inaccuracies, or does not include support from project management documentation Does not describe dependencies within the project that may be affected by the risk 6 Project Risk: Implications Meets “Proficient” criteria and explanation demonstrates a sophisticated awareness of possible risk results Explains within the context of the
  • 14.
    triple constraint theimplications for the project if the risk is not addressed Explains the implications for the project if the risk is not addressed, but explanation is illogical or cursory or is not within the context of the triple constraint Does not explain the implications for the project if the risk is not addressed 8 Risk Mitigation: Mitigate Meets “Proficient” criteria and explanation demonstrates a sophisticated awareness of steps needed to mitigate the identified risk Explains the steps that need to be taken in order to mitigate the identified risk Explains the steps that need to be taken in order to mitigate the identified risk, but explanation is illogical, cursory, or contains inaccuracies
  • 15.
    Does not explainthe steps that need to be taken in order to mitigate the identified risk 8 Risk Mitigation: Affect Meets “Proficient” criteria and explanation makes cogent connections between important project variables and the proposed risk mitigation strategy Explains in detail how the proposed mitigation strategy will affect the project, considering the triple constraint and any other variables deemed important including any tradeoffs that must be made to accommodate the mitigation strategy Explains how the proposed mitigation strategy will affect the project, but explanation lacks detail, is illogical, contains inaccuracies, does not consider the triple constraint and any other variables deemed
  • 16.
    important, or doesnot include tradeoffs that must be made to accommodate the mitigation strategy Does not explain how the proposed mitigation strategy will affect the project 8 Risk Mitigation: Best Course of Action Meets “Proficient” criteria and defense makes cogent connections between the proposed mitigation strategy and the project goals Defends why the proposed mitigation strategy is the best course of action for the project team Defends why the proposed mitigation strategy is the best course of action for the project team, but response is cursory or illogical or contains inaccuracies Does not defend why the proposed mitigation strategy is the best course of action for the
  • 17.
    project team 8 Conclusion Meets“Proficient” criteria and summary demonstrates an advanced ability to distill project information Summarizes the project needs for stakeholders Summarizes the needs for stakeholders, but summary is unclear or missing key components Does not summarize the project needs for stakeholders 8 Communication: Professional Meets “Proficient” criteria and email demonstrates an advanced ability to appropriately tailor communication to a specified audience Develops email communication in a clear and professional manner, using language appropriate for the audience of stakeholders
  • 18.
    Develops email communication ina professional manner, but language is not appropriate for the audience of stakeholders or information is not clear Does not develop email in a clear and professional manner using language appropriate for the audience of stakeholders 8 Communication: Documentation Meets “Proficient” criteria and supporting documentation is especially well-suited to aid in the communication of the proposed mitigation strategy Attaches supporting documentation to aid in the communication of the mitigation strategy Attaches supporting documentation to aid in the communication of the mitigation strategy, but documentation is incomplete or contains inaccuracies Does not attach supporting
  • 19.
    documentation to aidin the communication of the mitigation strategy 8 Articulation of Response Submission is free of errors related to citations, grammar, spelling, syntax, and organization Submission has no major errors related to citations, grammar, spelling, syntax, or organization Submission has major errors related to citations, grammar, spelling, syntax, or organization that negatively impact readability and articulation of main ideas Submission has critical errors related to citations, grammar, spelling, syntax, or organization that prevent understanding of ideas 4 Total 100%
  • 20.
    Regatta University IT ProjectCharter For Student Degree Progress Version 1.0 Table of Contents Document History 3 Executive Summary 4 Project Purpose/Justification 4 Project Description 4 Preliminary Scope Statement 4 Out of Scope 4 Project Objectives and Success Criteria 4 Constraints 4 Assumptions 4 Project Deliverables 5 Project Resource Estimate 5 Summary Milestone Schedule 5 Summary Budget 5 Project Approval Requirements 6 Project Organization 6 Authorization 6 Project Team 6 Directors of Assigned Resources 6 Project Sponsor 6
  • 21.
    Document History Document Revision/ReleaseStatus Revision Date Description of Changes Author / Editor 0.1 6/29/15 Initial format Jane Smith 1.0 8/31/15 Initial draft John Doe Executive Summary Students leverage a web portal to access university-related information and resources. Content within it can be targeted to all users or to those within a pre-specified role (e.g., students at a particular campus) or it can be user-specific. As an academic institution, one piece of information critical to students is their current progress in their degree program or programs. The purpose of the student degree progress project is to create an area to display user-specific academic progress. Project Purpose/Justification University leadership requested this project to promote student
  • 22.
    awareness and providestudents easy access to their degree progress. Project DescriptionPreliminary Scope Statement The purpose of this project is to create an area that displays user-specific academic progress within the appropriate roles, leveraging data through a back-end system. This project will include the necessary modifications to the back end to relay this information. More specifically, this project will include the following: · Creating the graphical elements in a web-friendly format · Creating the necessary web view to accommodate the graphical elements · Creating the necessary changes to the back end to prepare data supporting the student information · Creating the necessary web service to securely expose the student’s information to the graphical elements and web view Out of Scope Due to business-specific processes, some students, particularly those who have been pursuing a degree for over four years, may not be able to see their academic progress using the deliverables of this project. Changes to the back end to expand this functionality are out of scope, as are any changes intended to enhance functionality to provide additional data beyond the academic progress already captured in another system. Project Objectives and Success Criteria · The project will provide the functionality described within the preliminary scope statement. · The project will be delivered without incurring any additional expenses. · The project will be delivered free from any significant defects or without causing any down time. · The project will be delivered no later than two weeks from the target time frame defined within the milestone schedule below. Constraints · Additional funding is not available.
  • 23.
    · The informationavailable to students is derived from data within the back end and is as accurate, timely, and available as the source data and its structuring. Assumptions · No major changes in formatting or scope will be presented during the life of the project.Project Deliverables · Project Charter · Project Management Plan · Design · User Interface Mockup · Architectural Design · Test Plan · Test Scenarios Project Resource Estimate The student degree progress project is estimated to use the following resources: Project Resource Estimate Resource Estimated Work Hours Project Manager 48 Hours Systems Analyst 12 Hours Middleware Applications Developer 44 Hours Backend Systems Analyst 50 Hours Total: 154 Hours Summary Milestone Schedule Summary Milestone Schedule – List key project milestones relative to project start Project Milestone Target Date
  • 24.
    Project Start September 1 GraphicalComponent Unit Complete September 23 Web View Unit Complete September 25 Backend Unit Complete October 7 Integration Testing Complete October 14 Submit to Leadership October 26 Leadership Acceptance November 2 Transition to Production November 5 Project Closeout November 13 Summary Budget Fiscal Year Summary Budget – List component project costs Project Component Component Cost Hardware $0 Software and Licensing $0 Vendor N/A Total $0 Project Approval Requirements The project will be completed once all requirements are met and all deliverables have been received and approved by the client. Project Organization Role
  • 25.
    Name(s) – Department(s) ProjectSponsor Jane Smith Project Manager John Doe Core Stakeholder Arthur Bowman Vendor Resources None Project Team Members Shila Cole, Ana Fischer, John Jones Authorization Approval of this project charter provides authorization to move forward in accordance with the information contained in this document. Project Team 1 John Doe, Project Manager Shila Cole, Systems Analyst Ana Fischer, Middleware Application Developer John Jones, Backend Systems Analyst Date: Date: Date: Date: Directors of Assigned Resources Michael Erdmann, Middleware Director Amber McLedon, Applications Director Cynthia Carmom, PMO Director/Acting Student Systems Director
  • 26.
    Date: Date: Date: Project Sponsor Jane Smith,Project Sponsor Date: Project Scenario Project Scenario Regatta University is a leader in both traditional education and career-path development, including in emerging fields. The university prides itself on staying on the leading edge of curriculum and degree programs, learning methodologies and instructional technologies, student services, and demonstrated student success. “The future is here and now,” the university’s president, Martha Yoon, likes to say. Regatta serves approximately 8,000 students at locations including the original campus in Augusta, Maine, and satellite campuses in Ventura, California; Dayton, Ohio; and Hilo, Hawaii. In a typical term, approximately 40% of Regatta’s students take courses at a distance through the university’s online education hub. Enrollment growth has been strong, increasing by 4 to 8% each year for the last decade. You are a key member of the information technology team at Regatta, with a core specialization in student services. You are responsible for providing user-friendly interfaces connecting to a flexible, powerful information structure. Now you have a new project—working with colleagues to create a student degree progress tool that students will use for accurate, instant
  • 27.
    information on theirprogress toward program and degree completion. As you may imagine, this tool is eagerly awaited by a variety of stakeholders, including Regatta academic advisors and the Office of Enrollment Management, as tracking and communicating student progress toward degree completion is vital for retention. “We need a tool that will be easy to use but also accurate. No misinformation!” your team manager says. RACI ChartSteps will be highlighted if A and R are not assigned.R:Does the step RACI ChartA:Accountable for the stepC:Consulted with before the stepI:Informed when the step is completedProject:Student Degree ProgressDEPARTMENTInformation TechnologySTEPDESCRIPTIONJane SmithJohn DoeArthur BowmanShila ColeAna FischerJohn Jones1Create the project charterIA/R2Develop the project management planA/R3Define the project scopeA/RCC/III4Create a formal budget and budget planC/IA/RI5Fill in a Gantt chart with the project schedule and milestonesIA/RIC/III6Develop a user interface mockup for reviewA/R7Create the architectural design for the front end of the application (user-facing)A/R8Create the architectural design for the back end of the application (for data processing)A/R9Develop the graphic user interface (GUI) for the degree trackerA/R10Develop the web code to receive data from the back end and place data within the GUIA/R11Develop the back-end code to process data and send it to the web applicationA/R12Create a defined test plan for all system componentsA/RC/IC/I13Test the scenarios defined in the test plan for proper application behaviorA/RRR14Perform integration testing to ensure that the front-end components and back-end components speak to each other as well as integrate seamlessly with the rest of the web applicationIA/RRR15Transition web application into production environment (go-live)C/IA/RA/R16Monitor project progress throughout its life cycleA/RI17Manage project deliverables for records and hand-offA/RI18Assess and manage risks throughout the project life cycleA/RRRR19Develop the final project
  • 28.
    reportIA/RI20Perform project reflectionsA/RCCC WorkBreakdown Structure (WBS) 1.0 Student Degree Progress Project 1.1 Initiation 1.1.2 Project Management Plan 1.2 Planning 1.3.1.1 User Interface Mockup 1.3.1.2 Architectural Design - Main Application 1.3.2 Implementation 1.3.3.2 Test Scenarios 1.3.3.3 Integration Testing 1.3.4 Transition to Production 1.5 Project Closeout
  • 29.
    1.3.3 Testing 1.3.3.1 TestPlan 1.3.2.1 Graphical Component Unit 1.3.2.2 Web View Unit 1.3.2.3 Backend Unit 1.1.1 Project Charter 1.3 Execution 1.2.1 Scope Definition 1.2.3 Scheduling (Gantt Chart) 1.3.1 Design 1.2.2 Budget Plan 1.4.1 Final Project Report
  • 30.
    1.4.2 Project Reflections(Lessons Learned) 1.4 Controlling 1.4.1 Monitor Project Progress 1.4.2 Manage Deliverables 1.4.3 Assess and Manage Risks 1.3.1.3 Architectural Design - Backend
  • 32.
    Risk MatrixProject RiskLikelihoodImplicationsThere is a risk that severe weather in Sailcloth, Maine (the main campus that houses the development team), will close the campus and impact
  • 33.
    progress.MediumThere is arisk that the ambiguity in the project scope (it only defines "graphical element" but not what type) will lead to requirement changes by the stakeholder during development, affecting both the budget and schedule.HighThere is a risk that sign-off on project deliverables (charter, Gantt chart, product approval, etc.) from project sponsors and stakeholders exceeds the allotted time. This decision delay will impact the progress schedule.LowThere is a risk for rollout issues when deploying to production due to complexity of merging code with the "go-live" of another project on the same system.HighTwo projects are currently being developed at the same time in the same code base. Delays to the secondary project will cause delays to the Student Progress go- live.HighThe student portal where the project will be deployed is a high-availability system and is expected to be accessible for students 24/7. There is a risk that the large number of changes occurring during go-live could take the system offline, temporarily impacting system availability. LowThere is a risk that an interpersonal conflict will arise within the team, impacting the human resources assigned to the project and potentially impacting the allotted schedule.Low Team Member InfoRoleNameRole DescriptionJane SmithJohn DoeArthur BowmanShila ColeAna FischerJohn Jones
