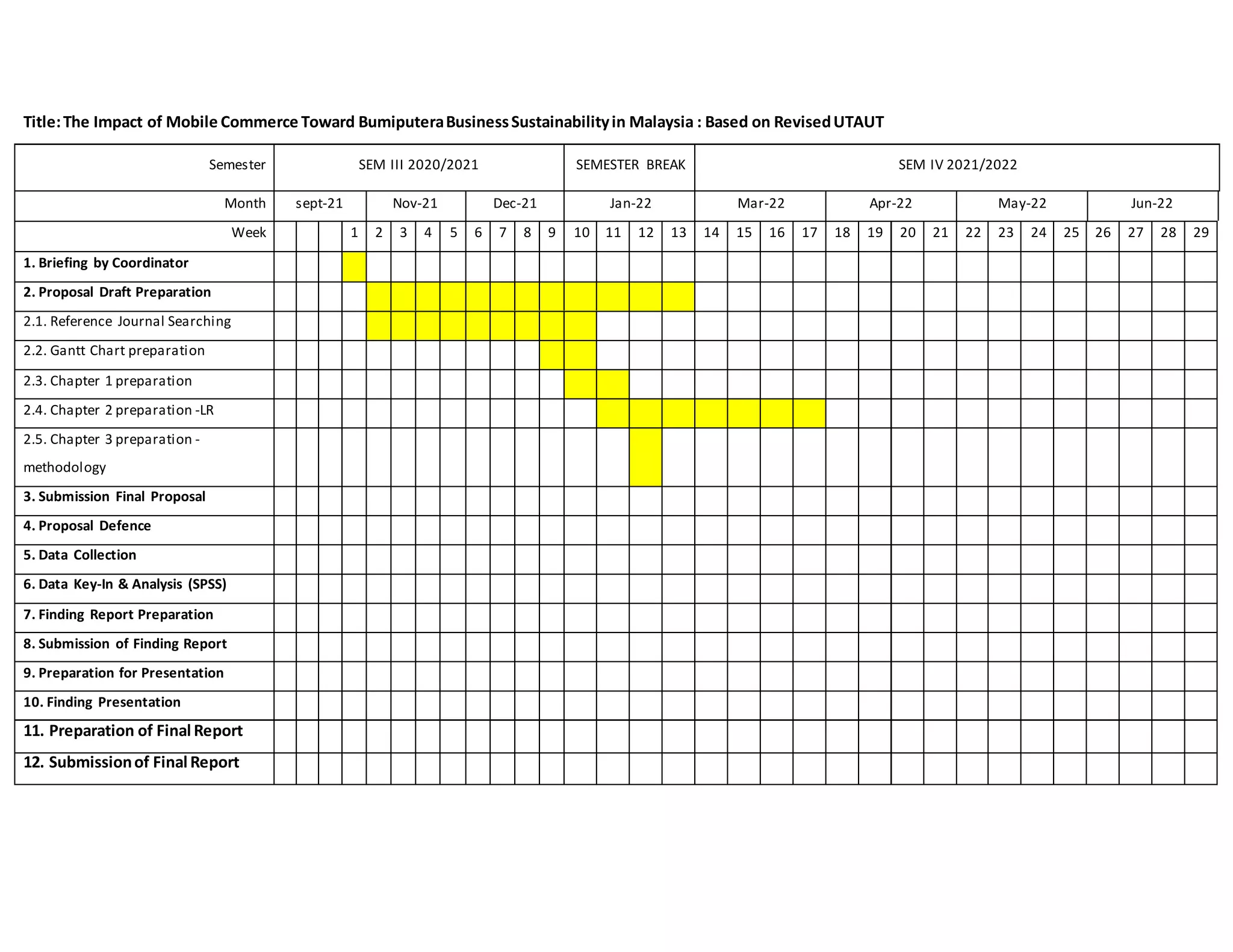

Title:The Impact of Mobile Commerce Toward BumiputeraBusinessSustainabilityin Malaysia : Based on RevisedUTAUT
Semester SEM III 2020/2021 SEMESTER BREAK SEM IV 2021/2022
Month sept-21 Nov-21 Dec-21 Jan-22 Mar-22 Apr-22 May-22 Jun-22
Week 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29
1. Briefing by Coordinator
2. Proposal Draft Preparation
2.1. Reference Journal Searching
2.2. Gantt Chart preparation
2.3. Chapter 1 preparation
2.4. Chapter 2 preparation -LR
2.5. Chapter 3 preparation -
methodology
3. Submission Final Proposal
4. Proposal Defence
5. Data Collection
6. Data Key-In & Analysis (SPSS)
7. Finding Report Preparation
8. Submission of Finding Report
9. Preparation for Presentation
10. Finding Presentation
11. Preparation of Final Report
12. Submissionof Final Report

gant chart.docx
