Integration
 Integ ation of Mic osoft P oject EPM
                Microsoft Project
 with SAP

 HR Integration with ResourceLink
 PS/PM/CO/CATS Integration with PSLink

© TPG The Project Group GmbH             Slide 1

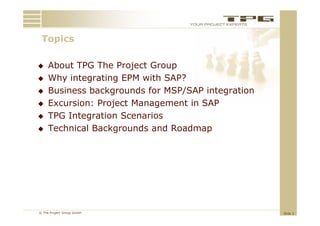

Topics
 T i

    About TPG The Project Group
    Why integrating EPM with SAP?
    Business backgrounds f MSP/SAP i
     B i      b k        d for         integration
                                               i
    Excursion: Project Management in SAP
    TPG I t
         Integration S
                 ti  Scenarios
                            i
    Technical Backgrounds and Roadmap

© The Project Group GmbH                             Slide 2

Our company – TPG Th Project Group
 O                 The P j t G

     Our Locations
         Headquarters in Munich Germany and Offices in Mainz
          and Dortmund
         Subsidiaries USA (PA), UK and Austria
     Our Business focus: Project Management and
      Project Management Software
     Our Partnerships and Certifications
         Microsoft Gold
          Certified Partner
         SAP certified product
          (TPG PSLink)
          (           k)
         Worldwide product implementation partners
          (Australia, Brazil, Denmark, Israel, South Africa,
          Singapore, Thailand)
© The Project Group GmbH                                        Slide 3
TPG W ld id S b idi i

     Worldwide Subsidiaries and P t
                              d Partners

© The Project Group GmbH                   Slide 4

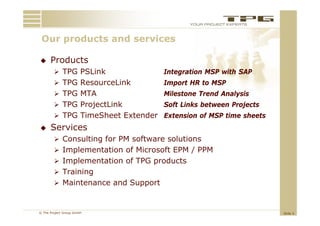

Our products and services
 O      d t     d     i

     Products
         TPG PSLink                Integration MSP with SAP
         TPG ResourceLink          Import HR to MSP
         TPG MTA                   Milestone Trend Analysis
         TPG ProjectLink           Soft Links between Projects
         TPG Ti
              TimeSheet E t d
                  Sh t Extender E
                                Extension of MSP time sheets
                                      i    f      i    h
     Services
         Consulting for PM software solutions
         Implementation of Microsoft EPM / PPM
         Implementation of TPG products
            p                   p
         Training
         Maintenance and Support

© The Project Group GmbH                                          Slide 5
TPG Customers (selection)
     C t       ( l ti )

© The Project Group GmbH     Slide 6
Why linking SAP with Microsoft EPM?

© TPG The Project Group GmbH           Slide 7

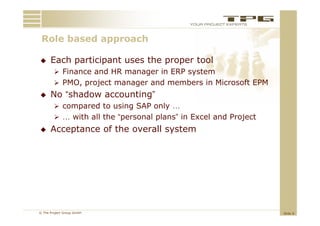

Role b
 R l based approach
         d        h

     Each participant uses the proper tool
         Finance and HR manager in ERP system
         PMO, project manager and members in Microsoft EPM
     No “shadow accounting”
         compared to using SAP only …
         … with all the “personal plans” in Excel and Project
     Acceptance of the overall system

© The Project Group GmbH                                         Slide 8

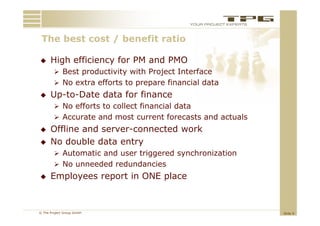

The best
 Th b t cost / benefit ratio
           t b     fit   ti

     High efficiency for PM and PMO
         Best productivity with Project Interface
         No extra efforts to prepare financial data
     Up-to-Date data for finance
         No efforts to collect financial data
         Accurate and most current forecasts and actuals
     Offline and server-connected work
     No double data
      N d bl d t entry   t
         Automatic and user triggered synchronization
         No unneeded redundancies
     Employees report in ONE place

© The Project Group GmbH                                    Slide 9

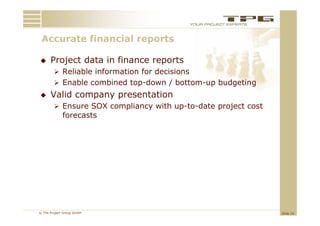

Accurate financial reports
 A     t fi     i l      t

     Project data in finance reports
         Reliable information for decisions
         Enable combined top-down / bottom-up budgeting
     Valid company presentation
         Ensure SOX compliancy with up-to-date project cost
             forecasts
             f      t

© The Project Group GmbH                                       Slide 10
Business backgrounds
 for MSP/SAP integration
 f           i t    ti

© TPG The Project Group GmbH   Slide 11

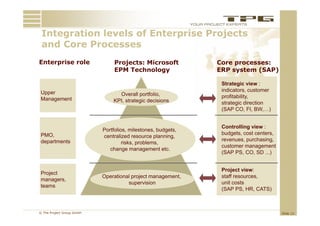

Integration levels of Enterprise Projects
 and Core Processes
Enterprise role                 Projects: Microsoft           Core processes:
                                EPM Technology                ERP system (SAP)

                                                               Strategic view :
 Upper                                                         indicators, customer
                                 Overall portfolio,            profitability,
 Management                    KPI, strategic decisions        strategic direction
                                                               (SAP CO, FI, BW,…)

                                                               Controlling view :
                           Portfolios, milestones, budgets,
 PMO,                                                          budgets, cost centers,
                           centralized resource planning,
                                                  p     g,
 departments                                                   revenues, purchasing
                                                               revenues purchasing,
                                    risks, problems,
                                                               customer management
                              change management etc.
                                                               (SAP PS, CO, SD ...)

                                                               Project view:
 Project
                           Operational project management,     staff resources,
 managers,
                                     supervision               unit costs
 teams
                                                               (SAP PS HR CATS)
                                                                      PS, HR,

© The Project Group GmbH                                                                Slide 12

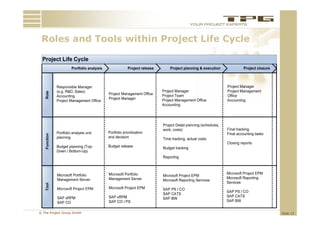

Roles and Tools within Project Life Cycle
 R l     dT l     ithi P j t Lif C l

© The Project Group GmbH                     Slide 13

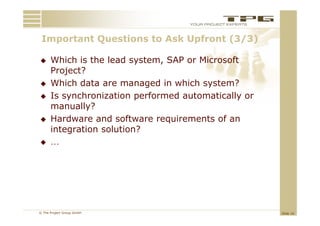

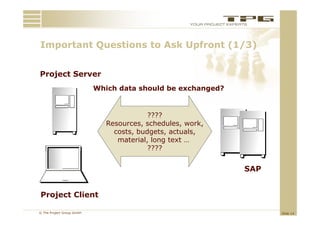

Important Questions to Ask Upfront (1/3)

Project Server
                           Which data should be exchanged?

                                          ????
                              Resources, schedules, work,
                                costs, budgets, actuals,
                                 material,
                                 material long text …
                                          ????

                                                             SAP

Project Client

© The Project Group GmbH                                           Slide 14

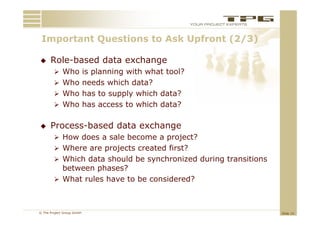

Important Questions to Ask Upfront (2/3)
 I    t tQ     ti    t A kU f     t

     Role based
      Role-based data exchange
         Who is planning with what tool?
         Who needs which data?
         Who has to supply which data?
         Who has access to which data?

     Process-based data exchange
         How does a sale become a project?
         Where are projects created first?
         Which data should be synchronized during transitions
          between phases?
         What rules have to be considered?

© The Project Group GmbH                                         Slide 15
Important Questions to Ask Upfront (3/3)
 I    t tQ     ti    t A kU f     t

     Which is the lead system, SAP or Microsoft
                         system
      Project?
     Which data are managed in which system?
                            g           y
     Is synchronization performed automatically or
      manually?
     Hardware and software requirements of an
      integration solution?
     …

© The Project Group GmbH                              Slide 16

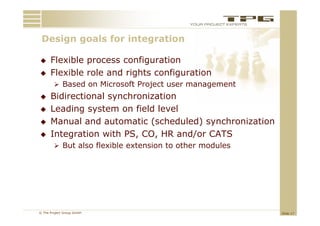

Design goals for integration
 D i       l f    i t    ti

     Flexible process configuration
     Flexible role and rights configuration
         Based on Microsoft Project user management
                                j             g
     Bidirectional synchronization
     Leading system on field level
             g y
     Manual and automatic (scheduled) synchronization
     Integration with PS, CO, HR and/or CATS
          g
         But also flexible extension to other modules

© The Project Group GmbH                                 Slide 17
Excursion:
Project Management in SAP

© TPG The Project Group GmbH   Slide 18

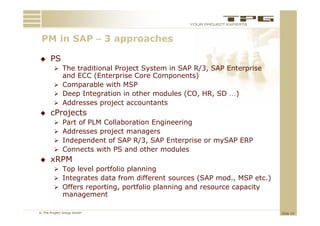

PM in SAP – 3 approaches
    i                 h

     PS
         The traditional Project System in SAP R/3, SAP Enterprise
          and ECC (Enterprise Core Components)
         Comparable with MSP
              p
         Deep Integration in other modules (CO, HR, SD …)
         Addresses project accountants
     cProjects
            Part of PLM Collaboration Engineering
            Addresses project managers
            Independent of SAP R/3, SAP E t
             I d      d t f      R/3       Enterprise or mySAP ERP
                                                  i        SAP
            Connects with PS and other modules
     xRPM
         Top level portfolio planning
         Integrates data from different sources (SAP mod., MSP etc.)
         Offers reporting, portfolio p
                   p     g, p         planning and resource capacity
                                             g                p    y
             management

© The Project Group GmbH                                                Slide 19
SAP PM Architecture Overview

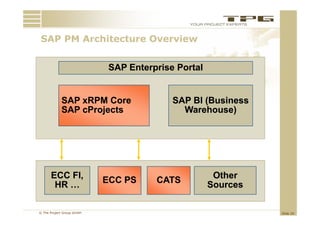

        A hit t      O    i

                            SAP Enterprise Portal

            SAP xRPM Core                 SAP BI (Business
            SAP cProjects
                    j                       Warehouse) )

      ECC FI,
          FI,                                        Other
                           ECC PS     CATS
       HR …                                         Sources

© The Project Group GmbH                                      Slide 20

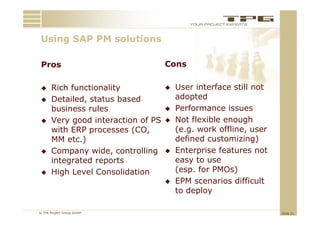

Using SAP PM solutions
 U i            l ti

 Pros
 P                                  Cons
                                    C

     Rich functionality               User interface still not
     Detailed, status based            adopted
      business rules                   Performance issues
     Very good interaction of PS      Not flexible enough
      with ERP processes (CO,           (e.g. work offline, user
      MM etc )
          etc.)                         defined customizing)
     Company wide, controlling        Enterprise features not
      integrated reports
          g        p                    easy to use
     High Level Consolidation          (esp. for PMOs)
                                       EPM scenarios difficult
                                        to deploy

© The Project Group GmbH                                           Slide 21
Overview: The TPG I t
 O    i    Th      Integrations Scenario
                          ti    S     i

                             Microsoft Portfolio Server
                Microsoft EPM and SQL Reporting services / SAP BW

                                    Manager
                                     PMO

  Microsoft Project                            SAP R/3 / Enterprise /
  EPM                                          MySAP ERP
                                               with CO PS
                                                    CO,
                                               HR, CATS

  PMO,
                                              Manager,
  p j
  project manager,
              g ,
                                              Controller,
                                              Controller
  Team member
                                              Dept. manager
© The Project Group GmbH                                                Slide 22
TPG Integration Scenarios

© TPG The Project Group GmbH   Slide 23

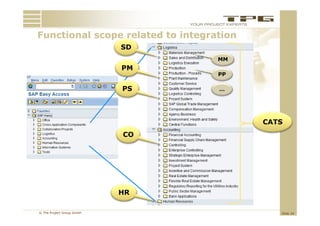

Functional scope related to integration

© The Project Group GmbH                  Slide 24

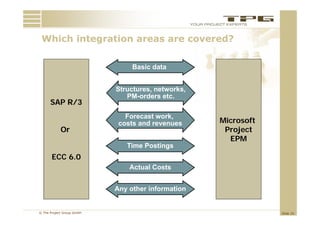

Which integration areas are covered?
 Whi h i t    ti                   d?

                                Basic data

                           Structures, networks,
                           St   t        t   k
                              PM-orders etc.
      SAP R/3
                              Forecast work,
                            costs and revenues     Microsoft
            Or                                      Project
                                                     EPM
                              Time Postings
       ECC 6.0
                               Actual Costs

                           Any other information

© The Project Group GmbH                                       Slide 25

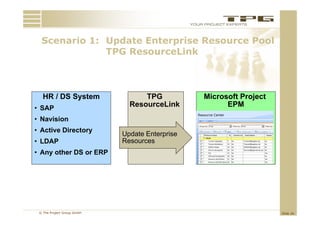

Scenario 1: Update Enterprise Resource Pool
              TPG ResourceLink

   HR / DS System                 TPG           Microsoft Project
• SAP
                              ResourceLink            EPM
• Navision
• Active Directory
                            Update Enterprise
• LDAP
   DAP                      Resources
                            R
• Any other DS or ERP

 © The Project Group GmbH                                           Slide 26

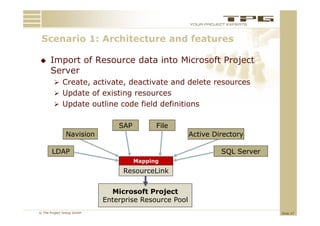

Scenario 1: A hit t
 S     i 1 Architecture and f t
                          d features

     Import of Resource data into Microsoft Project
      Server
         Create, activate, deactivate and delete resources
         Update of existing resources
         Update outline code field definitions

                               SAP         File
               Navision                               Active Directory

       LDAP                                                    SQL Server
                                     Mapping
                                ResourceLink

                             Microsoft P j t
                             Mi       ft Project
                           Enterprise Resource Pool
© The Project Group GmbH                                                    Slide 27

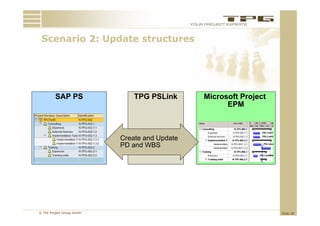

Scenario 2: U d t structures
 S     i 2 Update t     t

         SAP PS                TPG PSLink      Microsoft Project
                                                     EPM

                           Create and Update
                           PD and WBS

© The Project Group GmbH                                           Slide 28
Scenario 2: M

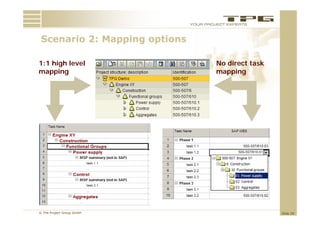

 S     i 2 Mapping options
               i     ti

1:1 high level
1 1 hi h l   l               No direct t k
                             N di    t task
mapping                      mapping

© The Project Group GmbH                      Slide 29

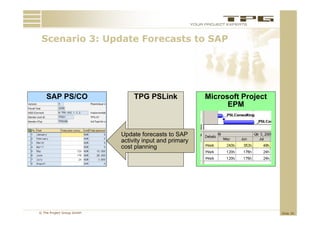

Scenario 3: Update Forecasts to SAP
 S     i 3 U d t F         t t

    SAP PS/CO                  TPG PSLink               Microsoft Project
                                                              EPM

                           Update forecasts to SAP
                           activity input and primary
                             ti it i    t d i
                           cost planning

© The Project Group GmbH                                                    Slide 30

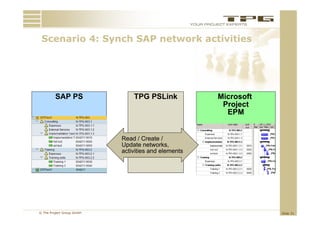

Scenario 4: Synch SAP network activities
 S     i 4 S     h       t   k   ti iti

         SAP PS                TPG PSLink            Microsoft
                                                      Project
                                                       EPM

                           Read / Create /
                           Update networks,
                           activities and elements

© The Project Group GmbH                                         Slide 31
Scenario 4: Example for activity element
             mapping

© The Project Group GmbH                    Slide 32

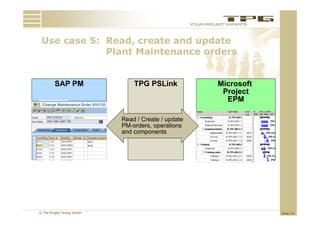

Use case 5: Read, create and update
             Plant Maintenance orders

        SAP PM                 TPG PSLink           Microsoft
                                                     Project
                                                      EPM

                           Read / Create / update
                           PM-orders, operations
                           and components

© The Project Group GmbH                                        Slide 33
Scenario 6: Synch ti
 S     i 6 S     h time postings with CATS
                           ti     ith

     SAP CATS                  TPG PSLink         Microsoft Project
                                                        EPM

                           Read / Create /
                           Update CATS postings

© The Project Group GmbH                                              Slide 34

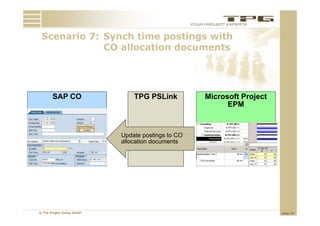

Scenario 7: Synch time postings with
             CO allocation documents

       SAP CO                  TPG PSLink          Microsoft Project
                                                         EPM

                           Update postings to CO
                           allocation documents

© The Project Group GmbH                                               Slide 35
Scenario 8: Exchange any data to any RFC

SAP (any module)                TPG PSLink       Microsoft Project
                                                EPM or SharePoint

                            Any data with any
                            BAPI /RFC

 © The Project Group GmbH                                            Slide 36
© The Project Group GmbH   Slide 37
TPG PSLink
Technical Backgrounds and Roadmap

© TPG The Project Group GmbH        Slide 38

TPG PSLink architecture
      PSLi k    hit t
                                                       PSLink Server Framework

SAP R/3                                                     Basic services
                   BAPI/RF or Net
                                                (session handling, logging, user rights etc.)            MSP Server
ECC 6.0
                                                                                                        2003 or 2007
                                                             Connectors
                                          SAP Access         WBS                   TPG Project
                         FC

    HR                                    Framework                                  Access
                                                             Networks
                                                             PM Orders             Framework
                                           PSLink SAP                                                     MSP DB
  CATS                                     object model      Forecast cost         TPG Project Server        +
                                tweaver

                                           SAP .Net          and revenues          object model
                                                                                                          external
     PS                                    Connector                               Direct DB PDS          sources
                                                             Timesheets
                                           SAP DCOM                                Operations PSI
                                           Connector
    PM                                                       RFC

    CO
                     RFC Extensions

                                                             Client Interface

 Others
                                                             Server Interface                            MSP Prof.
                                              User Interface                         AddIn
                                           (Menu, History
                                           (Menu History, Logs etc )
                                                               etc.)            using Project Client
                                                                                    object model

                                                       PSLink Client Framework
 © The Project Group GmbH                                                                                              Slide 39

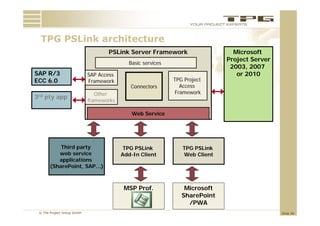

TPG PSLink architecture
      PSLi k    hit t
                                   PSLink Server Framework                  Microsoft
                                                                          Project Server
                                                                             j
                                           Basic
                                           B i services
                                                   i
                                                                           2003, 2007
SAP R/3                     SAP Access                                       or 2010
ECC 6.0                     Framework                     TPG Project
                                            Connectors      Access
                               Other                      Framework
3rd pty app
                            frameworks

                                            Web Service

           Third party                    TPG PSLink         TPG PSLink
           web service                   Add-In Client       Web Client
           applications
       (SharePoint, SAP…)
       (Sh   P i     SAP )

                                          MSP Prof.           Microsoft
                                                             SharePoint
                                                               /PWA
 © The Project Group GmbH                                                                  Slide 40
TPG PSLink C fi
     PSLi k Configuration example
                     ti        l
                           <job>
                            <id>MasterSynchPDandWBS</id>
                            <shortDesc>Sync PD and WBS</shortDesc>
                            <sort>3</sort>
                             ...
                            <securityGroups><group>Executives</group></securityGroups>
                            <actions>
                                 <trycatch>
                                     <try>
                                         ...
                                         <QueryProject>
                                             <query> SELECT P.EnterpriseTextFields('SAPProjectDef') AS PSPID,
                                                          P.Name
                                                          P Name as Description
                                                                    Description,
                                                          SUBSTRING(P.EnterpriseTextFields('SAPProfile'),1,7)
                                                                    AS Project_Profile,
                                                          TO_DATETIME(P.InfoStartDate.Date) AS StartDate,
                                                          TO_DATETIME(P.InfoFinishDate.Date) AS FinishDate
                                                FROM Projects P
                                                WHERE P.EnterpriseFlagFields('SynchToSAP')
                                                          AND P.EnterpriseTextFields('MSPStatus')= '3 Active'
                                             </query>
                                             <output>
                                                <getProperty name="outputTable" target="Parameters.PDTable"/>
                                                 g     p y            p            g
                                                </output>
                                             </QueryProject>

                                             <If>
                                                <condition>Parameters.PDTable.Rows.Count > 0</condition>
                                                <thenJobId>JobSynchPD</thenJobId>
                                             </If>
                                       ...

© The Project Group GmbH                                                                                        Slide 41
TPG PSLink Hi t
                              PSLi k History and R d
                                               d Roadmap
                                                                                                                                                                                      v 2010
                                                                                                                                                                                      on EPM 2010
                                                                                                                                                       v 2007
                                                                                                                      v 3.1                                                           Additional
                                                                                                                                                       on EPM 2007

                                                     ontrolling Edition (CE)
                                                                               v 3.0                                  EPM 2003
                                                                                                                                                                                      features:
                                                                               EPM 2003                                                                                               Portfolio
                                                                                                                                                       Additional                     integration
                                                                      n                                               Integrates both                  features:                      New fields

                                                                                                                                                                         PSLin 2010
                                                                               New platform                           PSLink SE and CE                 New time sheet                 SharePoint
                                                                               Extensive configuration

                                                                                                                                         PSLink 2007
                                                                                                                                                       integration                    Connector

                                                                                                         PSLink 3.1
                                                                                                                      Enhanced config
                  SE)

                                                                                                                                                       Server events
                                 v 1.5

                                                                                                                                                                             nk
                                                                               High level integration                 More use cases

                                                                                                                3
                                                                                                                                                       WSS workflows
                                                              g
 tandard Edition (S

                                 MSP 2000                                      - Flexible WBS synch                                                    Budget and cost
                                                                               - Forecasts                            New connectors:                  resources
                                 Editing rules                                 - CATS integration
                                 through MSP                                                                          - Network
                                                                               - Report data                          - CO alloc docs
                                 events
                                                    Co

                                                                                                                      - xRPM
         E

                                 COM Add-In
                                        dd
                        v 1.0
                        MSP 98             v 2.0                                v 3.0
                                           EPM 2002/3                           EPM 2003
                        Down-Upload
                        D     U l d
St

                        Rules check        Server based                         Better logging
                        Locking            All PS objects                       and configuration
                        mechanism                                               New wizard

                        1999       2000             2002/3                          2004                2006                       2007                                    2009               2010

                         © The Project Group GmbH                                                                                                                                                    Slide 42
Summary and Integration Benefits

© TPG The Project Group GmbH       Slide 43

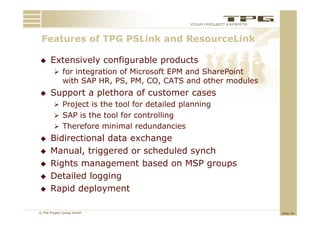

Features of TPG PSLi k and ResourceLink
 F t       f     PSLink   dR        Li k

     Extensively configurable products
         for integration of Microsoft EPM and SharePoint
             with SAP HR, PS, PM, CO, CATS and other modules
     Support a plethora of customer cases
         Project is the tool for detailed planning
         SAP i th t l f
              is the tool for controlling
                                 t lli
         Therefore minimal redundancies
     Bidirectional data exchange
     Manual, triggered or scheduled synch
     Rights management based on MSP groups
     Detailed logging
     Rapid deployment

© The Project Group GmbH                                       Slide 44
Integration Benefits
 I t    ti   B   fit

     No double data entry
     Offline work with SAP data
     Each participant works with the proper tool
         Accountants and HR manager in ERP system
         PMO, project manager and members in MSP
     Controlling forecasts contain also project data
         Valid company presentation
     Employees report in ONE place
     Reports are more meaningful
         Contain d
                  data f
                       from the other system
                             h    h
     Workflows can span over both systems

© The Project Group GmbH                                Slide 45
Partner in Poland:        Tel: +48 (22) 465 97 76
   FirstON SA                Fax: +48 (22) 490 79 67
   www.FirstON.pl            biuro@FirstON.pl

    The Project Group GmbH   Fon: +49 (89) 61 55 93 - 30
    Destouchesstr. 68        Fax: +49 (89) 61 55 93 - 40
    80796 Munich             info@TheProjectGroup.de
                             info@TheProjectGroup de
    Germany                  www.TheProjectGroup.de

© The Project Group GmbH                                   Slide 46

EPM_SAP_Integration_TPG_PSLink_FirstON

  • 1.
    Integration Integ ationof Mic osoft P oject EPM Microsoft Project with SAP HR Integration with ResourceLink PS/PM/CO/CATS Integration with PSLink © TPG The Project Group GmbH Slide 1
  • 2.
    Topics T i  About TPG The Project Group  Why integrating EPM with SAP?  Business backgrounds f MSP/SAP i B i b k d for integration i  Excursion: Project Management in SAP  TPG I t Integration S ti Scenarios i  Technical Backgrounds and Roadmap © The Project Group GmbH Slide 2
  • 3.
    Our company –TPG Th Project Group O The P j t G  Our Locations  Headquarters in Munich Germany and Offices in Mainz and Dortmund  Subsidiaries USA (PA), UK and Austria  Our Business focus: Project Management and Project Management Software  Our Partnerships and Certifications  Microsoft Gold Certified Partner  SAP certified product (TPG PSLink) ( k)  Worldwide product implementation partners (Australia, Brazil, Denmark, Israel, South Africa, Singapore, Thailand) © The Project Group GmbH Slide 3
  • 4.
    TPG W ldid S b idi i Worldwide Subsidiaries and P t d Partners © The Project Group GmbH Slide 4
  • 5.
    Our products andservices O d t d i  Products  TPG PSLink Integration MSP with SAP  TPG ResourceLink Import HR to MSP  TPG MTA Milestone Trend Analysis  TPG ProjectLink Soft Links between Projects  TPG Ti TimeSheet E t d Sh t Extender E Extension of MSP time sheets i f i h  Services  Consulting for PM software solutions  Implementation of Microsoft EPM / PPM  Implementation of TPG products p p  Training  Maintenance and Support © The Project Group GmbH Slide 5
  • 6.
    TPG Customers (selection) C t ( l ti ) © The Project Group GmbH Slide 6
  • 7.
    Why linking SAPwith Microsoft EPM? © TPG The Project Group GmbH Slide 7
  • 8.
    Role b Rl based approach d h  Each participant uses the proper tool  Finance and HR manager in ERP system  PMO, project manager and members in Microsoft EPM  No “shadow accounting”  compared to using SAP only …  … with all the “personal plans” in Excel and Project  Acceptance of the overall system © The Project Group GmbH Slide 8
  • 9.
    The best Thb t cost / benefit ratio t b fit ti  High efficiency for PM and PMO  Best productivity with Project Interface  No extra efforts to prepare financial data  Up-to-Date data for finance  No efforts to collect financial data  Accurate and most current forecasts and actuals  Offline and server-connected work  No double data N d bl d t entry t  Automatic and user triggered synchronization  No unneeded redundancies  Employees report in ONE place © The Project Group GmbH Slide 9
  • 10.
    Accurate financial reports A t fi i l t  Project data in finance reports  Reliable information for decisions  Enable combined top-down / bottom-up budgeting  Valid company presentation  Ensure SOX compliancy with up-to-date project cost forecasts f t © The Project Group GmbH Slide 10
  • 11.
    Business backgrounds forMSP/SAP integration f i t ti © TPG The Project Group GmbH Slide 11
  • 12.
    Integration levels ofEnterprise Projects and Core Processes Enterprise role Projects: Microsoft Core processes: EPM Technology ERP system (SAP) Strategic view : Upper indicators, customer Overall portfolio, profitability, Management KPI, strategic decisions strategic direction (SAP CO, FI, BW,…) Controlling view : Portfolios, milestones, budgets, PMO, budgets, cost centers, centralized resource planning, p g, departments revenues, purchasing revenues purchasing, risks, problems, customer management change management etc. (SAP PS, CO, SD ...) Project view: Project Operational project management, staff resources, managers, supervision unit costs teams (SAP PS HR CATS) PS, HR, © The Project Group GmbH Slide 12
  • 13.
    Roles and Toolswithin Project Life Cycle R l dT l ithi P j t Lif C l © The Project Group GmbH Slide 13
  • 14.
    Important Questions toAsk Upfront (1/3) Project Server Which data should be exchanged? ???? Resources, schedules, work, costs, budgets, actuals, material, material long text … ???? SAP Project Client © The Project Group GmbH Slide 14
  • 15.
    Important Questions toAsk Upfront (2/3) I t tQ ti t A kU f t  Role based Role-based data exchange  Who is planning with what tool?  Who needs which data?  Who has to supply which data?  Who has access to which data?  Process-based data exchange  How does a sale become a project?  Where are projects created first?  Which data should be synchronized during transitions between phases?  What rules have to be considered? © The Project Group GmbH Slide 15
  • 16.
    Important Questions toAsk Upfront (3/3) I t tQ ti t A kU f t  Which is the lead system, SAP or Microsoft system Project?  Which data are managed in which system? g y  Is synchronization performed automatically or manually?  Hardware and software requirements of an integration solution?  … © The Project Group GmbH Slide 16
  • 17.
    Design goals forintegration D i l f i t ti  Flexible process configuration  Flexible role and rights configuration  Based on Microsoft Project user management j g  Bidirectional synchronization  Leading system on field level g y  Manual and automatic (scheduled) synchronization  Integration with PS, CO, HR and/or CATS g  But also flexible extension to other modules © The Project Group GmbH Slide 17
  • 18.
    Excursion: Project Management inSAP © TPG The Project Group GmbH Slide 18
  • 19.
    PM in SAP– 3 approaches i h  PS  The traditional Project System in SAP R/3, SAP Enterprise and ECC (Enterprise Core Components)  Comparable with MSP p  Deep Integration in other modules (CO, HR, SD …)  Addresses project accountants  cProjects  Part of PLM Collaboration Engineering  Addresses project managers  Independent of SAP R/3, SAP E t I d d t f R/3 Enterprise or mySAP ERP i SAP  Connects with PS and other modules  xRPM  Top level portfolio planning  Integrates data from different sources (SAP mod., MSP etc.)  Offers reporting, portfolio p p g, p planning and resource capacity g p y management © The Project Group GmbH Slide 19
  • 20.
    SAP PM ArchitectureOverview A hit t O i SAP Enterprise Portal SAP xRPM Core SAP BI (Business SAP cProjects j Warehouse) ) ECC FI, FI, Other ECC PS CATS HR … Sources © The Project Group GmbH Slide 20
  • 21.
    Using SAP PMsolutions U i l ti Pros P Cons C  Rich functionality  User interface still not  Detailed, status based adopted business rules  Performance issues  Very good interaction of PS  Not flexible enough with ERP processes (CO, (e.g. work offline, user MM etc ) etc.) defined customizing)  Company wide, controlling  Enterprise features not integrated reports g p easy to use  High Level Consolidation (esp. for PMOs)  EPM scenarios difficult to deploy © The Project Group GmbH Slide 21
  • 22.
    Overview: The TPGI t O i Th Integrations Scenario ti S i Microsoft Portfolio Server Microsoft EPM and SQL Reporting services / SAP BW Manager PMO Microsoft Project SAP R/3 / Enterprise / EPM MySAP ERP with CO PS CO, HR, CATS PMO, Manager, p j project manager, g , Controller, Controller Team member Dept. manager © The Project Group GmbH Slide 22
  • 23.
    TPG Integration Scenarios ©TPG The Project Group GmbH Slide 23
  • 24.
    Functional scope relatedto integration © The Project Group GmbH Slide 24
  • 25.
    Which integration areasare covered? Whi h i t ti d? Basic data Structures, networks, St t t k PM-orders etc. SAP R/3 Forecast work, costs and revenues Microsoft Or Project EPM Time Postings ECC 6.0 Actual Costs Any other information © The Project Group GmbH Slide 25
  • 26.
    Scenario 1: UpdateEnterprise Resource Pool TPG ResourceLink HR / DS System TPG Microsoft Project • SAP ResourceLink EPM • Navision • Active Directory Update Enterprise • LDAP DAP Resources R • Any other DS or ERP © The Project Group GmbH Slide 26
  • 27.
    Scenario 1: Ahit t S i 1 Architecture and f t d features  Import of Resource data into Microsoft Project Server  Create, activate, deactivate and delete resources  Update of existing resources  Update outline code field definitions SAP File Navision Active Directory LDAP SQL Server Mapping ResourceLink Microsoft P j t Mi ft Project Enterprise Resource Pool © The Project Group GmbH Slide 27
  • 28.
    Scenario 2: Ud t structures S i 2 Update t t SAP PS TPG PSLink Microsoft Project EPM Create and Update PD and WBS © The Project Group GmbH Slide 28
  • 29.
    Scenario 2: M S i 2 Mapping options i ti 1:1 high level 1 1 hi h l l No direct t k N di t task mapping mapping © The Project Group GmbH Slide 29
  • 30.
    Scenario 3: UpdateForecasts to SAP S i 3 U d t F t t SAP PS/CO TPG PSLink Microsoft Project EPM Update forecasts to SAP activity input and primary ti it i t d i cost planning © The Project Group GmbH Slide 30
  • 31.
    Scenario 4: SynchSAP network activities S i 4 S h t k ti iti SAP PS TPG PSLink Microsoft Project EPM Read / Create / Update networks, activities and elements © The Project Group GmbH Slide 31
  • 32.
    Scenario 4: Examplefor activity element mapping © The Project Group GmbH Slide 32
  • 33.
    Use case 5:Read, create and update Plant Maintenance orders SAP PM TPG PSLink Microsoft Project EPM Read / Create / update PM-orders, operations and components © The Project Group GmbH Slide 33
  • 34.
    Scenario 6: Synchti S i 6 S h time postings with CATS ti ith SAP CATS TPG PSLink Microsoft Project EPM Read / Create / Update CATS postings © The Project Group GmbH Slide 34
  • 35.
    Scenario 7: Synchtime postings with CO allocation documents SAP CO TPG PSLink Microsoft Project EPM Update postings to CO allocation documents © The Project Group GmbH Slide 35
  • 36.
    Scenario 8: Exchangeany data to any RFC SAP (any module) TPG PSLink Microsoft Project EPM or SharePoint Any data with any BAPI /RFC © The Project Group GmbH Slide 36
  • 37.
    © The ProjectGroup GmbH Slide 37
  • 38.
    TPG PSLink Technical Backgroundsand Roadmap © TPG The Project Group GmbH Slide 38
  • 39.
    TPG PSLink architecture PSLi k hit t PSLink Server Framework SAP R/3 Basic services BAPI/RF or Net (session handling, logging, user rights etc.) MSP Server ECC 6.0 2003 or 2007 Connectors SAP Access WBS TPG Project FC HR Framework Access Networks PM Orders Framework PSLink SAP MSP DB CATS object model Forecast cost TPG Project Server + tweaver SAP .Net and revenues object model external PS Connector Direct DB PDS sources Timesheets SAP DCOM Operations PSI Connector PM RFC CO RFC Extensions Client Interface Others Server Interface MSP Prof. User Interface AddIn (Menu, History (Menu History, Logs etc ) etc.) using Project Client object model PSLink Client Framework © The Project Group GmbH Slide 39
  • 40.
    TPG PSLink architecture PSLi k hit t PSLink Server Framework Microsoft Project Server j Basic B i services i 2003, 2007 SAP R/3 SAP Access or 2010 ECC 6.0 Framework TPG Project Connectors Access Other Framework 3rd pty app frameworks Web Service Third party TPG PSLink TPG PSLink web service Add-In Client Web Client applications (SharePoint, SAP…) (Sh P i SAP ) MSP Prof. Microsoft SharePoint /PWA © The Project Group GmbH Slide 40
  • 41.
    TPG PSLink Cfi PSLi k Configuration example ti l <job> <id>MasterSynchPDandWBS</id> <shortDesc>Sync PD and WBS</shortDesc> <sort>3</sort> ... <securityGroups><group>Executives</group></securityGroups> <actions> <trycatch> <try> ... <QueryProject> <query> SELECT P.EnterpriseTextFields('SAPProjectDef') AS PSPID, P.Name P Name as Description Description, SUBSTRING(P.EnterpriseTextFields('SAPProfile'),1,7) AS Project_Profile, TO_DATETIME(P.InfoStartDate.Date) AS StartDate, TO_DATETIME(P.InfoFinishDate.Date) AS FinishDate FROM Projects P WHERE P.EnterpriseFlagFields('SynchToSAP') AND P.EnterpriseTextFields('MSPStatus')= '3 Active' </query> <output> <getProperty name="outputTable" target="Parameters.PDTable"/> g p y p g </output> </QueryProject> <If> <condition>Parameters.PDTable.Rows.Count > 0</condition> <thenJobId>JobSynchPD</thenJobId> </If> ... © The Project Group GmbH Slide 41
  • 42.
    TPG PSLink Hit PSLi k History and R d d Roadmap v 2010 on EPM 2010 v 2007 v 3.1 Additional on EPM 2007 ontrolling Edition (CE) v 3.0 EPM 2003 features: EPM 2003 Portfolio Additional integration n Integrates both features: New fields PSLin 2010 New platform PSLink SE and CE New time sheet SharePoint Extensive configuration PSLink 2007 integration Connector PSLink 3.1 Enhanced config SE) Server events v 1.5 nk High level integration More use cases 3 WSS workflows g tandard Edition (S MSP 2000 - Flexible WBS synch Budget and cost - Forecasts New connectors: resources Editing rules - CATS integration through MSP - Network - Report data - CO alloc docs events Co - xRPM E COM Add-In dd v 1.0 MSP 98 v 2.0 v 3.0 EPM 2002/3 EPM 2003 Down-Upload D U l d St Rules check Server based Better logging Locking All PS objects and configuration mechanism New wizard 1999 2000 2002/3 2004 2006 2007 2009 2010 © The Project Group GmbH Slide 42
  • 43.
    Summary and IntegrationBenefits © TPG The Project Group GmbH Slide 43
  • 44.
    Features of TPGPSLi k and ResourceLink F t f PSLink dR Li k  Extensively configurable products  for integration of Microsoft EPM and SharePoint with SAP HR, PS, PM, CO, CATS and other modules  Support a plethora of customer cases  Project is the tool for detailed planning  SAP i th t l f is the tool for controlling t lli  Therefore minimal redundancies  Bidirectional data exchange  Manual, triggered or scheduled synch  Rights management based on MSP groups  Detailed logging  Rapid deployment © The Project Group GmbH Slide 44
  • 45.
    Integration Benefits It ti B fit  No double data entry  Offline work with SAP data  Each participant works with the proper tool  Accountants and HR manager in ERP system  PMO, project manager and members in MSP  Controlling forecasts contain also project data  Valid company presentation  Employees report in ONE place  Reports are more meaningful  Contain d data f from the other system h h  Workflows can span over both systems © The Project Group GmbH Slide 45
  • 46.
    Partner in Poland: Tel: +48 (22) 465 97 76 FirstON SA Fax: +48 (22) 490 79 67 www.FirstON.pl biuro@FirstON.pl The Project Group GmbH Fon: +49 (89) 61 55 93 - 30 Destouchesstr. 68 Fax: +49 (89) 61 55 93 - 40 80796 Munich info@TheProjectGroup.de info@TheProjectGroup de Germany www.TheProjectGroup.de © The Project Group GmbH Slide 46
