Satellite management and control demands complex processes and resources and involves teams of highly qualified specialists running services 24 hours a day, 365 days a year, even throughout decades in case of fleets of large geostationary telecommunication spacecrafts.

Program cost predetermination at start-up and resource management at execution, become strategic to gain and maintain excellent quality performances and company reputation along whole program operating life and more.

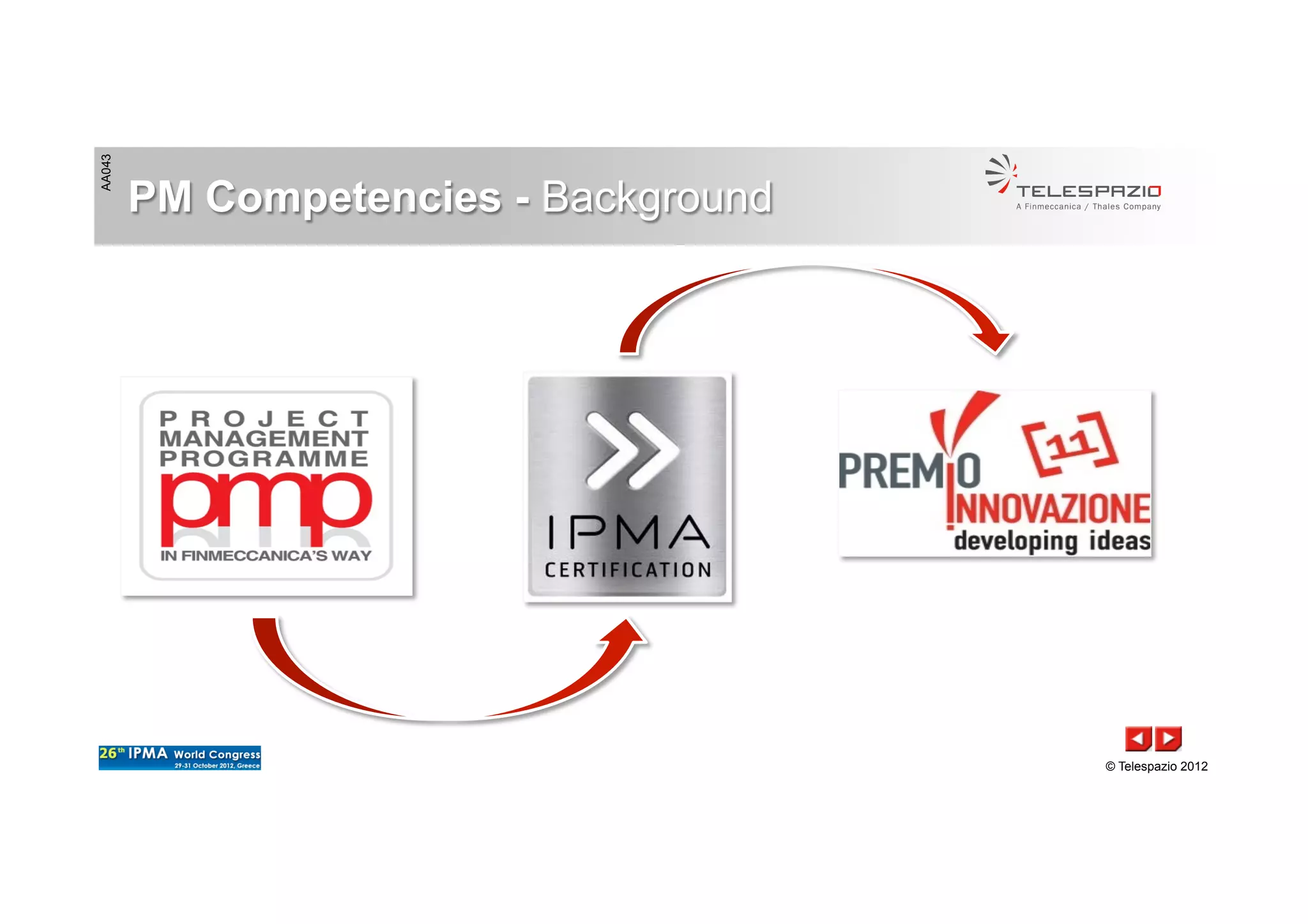

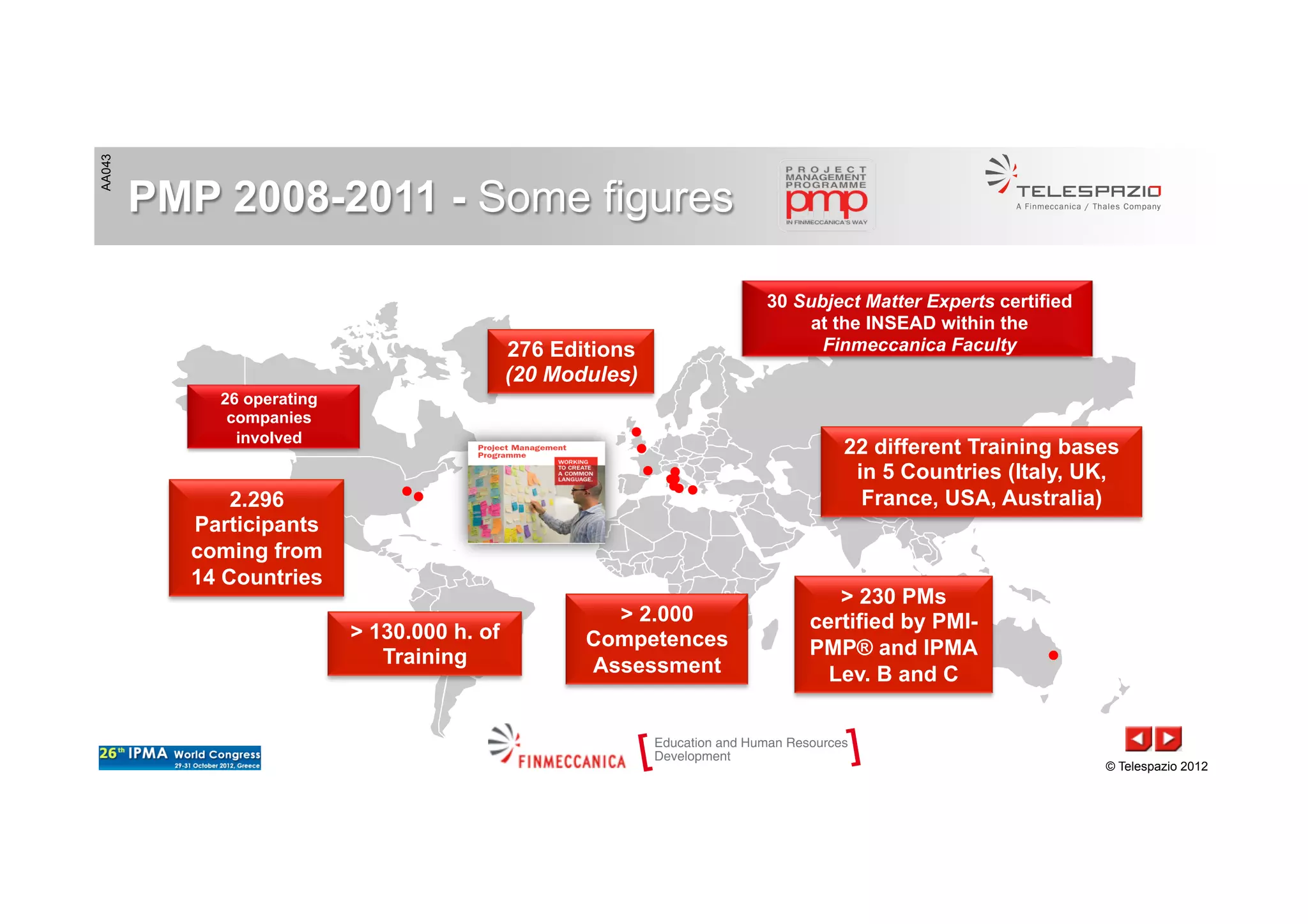

Adoption of PM structured approach during the recent years, together with international engineering and quality standards, enables Telespazio to run effective cost accounting of long term programs, obtaining significant improvement in main financial and economic figures.

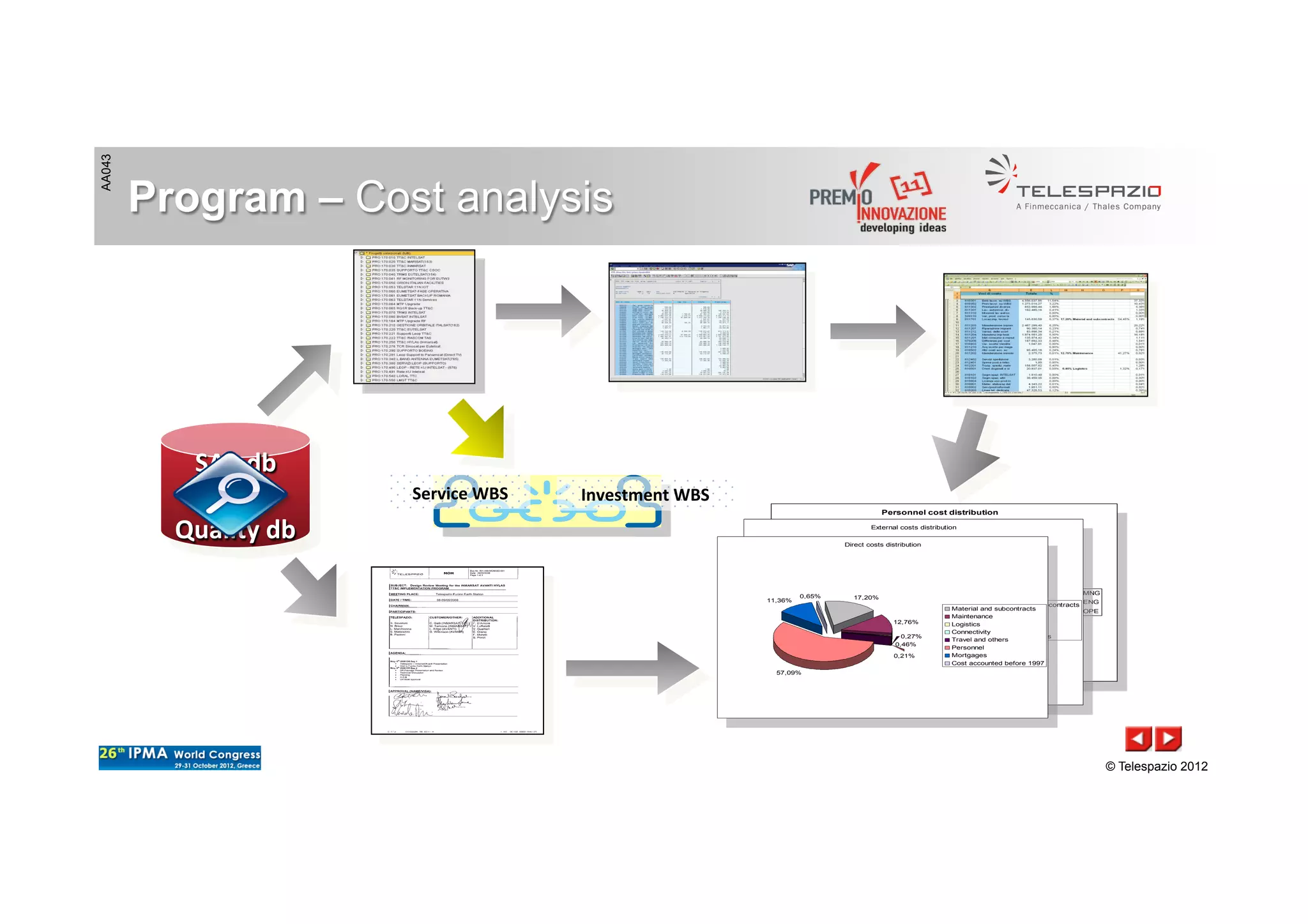

A post-analysis on these activities, grouped under a dedicated Program Office, has been performed through a cross-reference between direct costs, quality recordings and lessons learned, when available.
The outcome of this analysis has been successfully applied in rapid cost estimating against long term order budgeting process.
This paper has been presented at IPMA World Congress 2012 and awarded of Special Mention at Telespazio Innovation Award 2011.
