MMX: CREATING CHOICES IN SEABORNE IRON
ORE SUPPLY
Rio de Janeiro | February 2012
This presentation relating to MMX Mineração e Metálicos S.A. (“MMX”) includes “forward-looking statements”, as that term
is defined in the Private Securities Litigation Reform Act of 1995, in Section 27A of the Securities Act of 1933 and Section
21E of the U.S. Securities Exchange Act of 1934. All statements other than statements of historical facts are statements
that could be deemed forward-looking statements and are often characterized by the use of words such as “projects”,
“expects”, “anticipates”, “intends”, “plans”, “believes”, “estimates”, “may”, “will”, or “intends”, or by discussions or
comments about our objectives, strategy, plans or intentions and results of operations. Forward-looking statements include
projections regarding our operating capacity, operating expenditures, capital expenditures and start-up dates.
By their nature, these forward-looking statements involve numerous assumptions, uncertainties and opportunities, both
general and specific. The risk exists that these statements may not be fulfilled or, even if they are fulfilled, the results or
developments described in such statements may not be indicative of results or developments in future periods. We caution
participants of this presentation not to place undue reliance on these forward-looking statements as a number of factors
DISCLAIMER
could cause future results to differ materially from these statements.
Forward-looking statements may be influenced in particular by factors such as the ability to obtain all required regulatory
approvals on a timely basis or at all, exploration for mineral resources and reserves, difficulty in converting geological
resources into mineral reserves, and changes in economic, political and regulatory conditions. We caution that the
foregoing list is not exhaustive. When relying on forward-looking statements to make decisions, investors should carefully
consider these factors as well as other uncertainties and events.
MMX does not undertake to update our forward-looking statements unless required by law. This presentation is neither an
offer to sell (which can only be made pursuant to definitive offering documents) nor a solicitation of an offer to buy any
securities in the United States, or any other jurisdiction. The securities referred to herein have not been registered in any
jurisdiction, and in particular, will not be registered under the U.S. Securities Act of 1933, as amended, or any applicable
state securities laws and may not be offered or sold in the United States absent registration or an applicable exemption
from such registration requirements.
This presentation and its contents are proprietary information and may not be reproduced or otherwise disseminated in
whole or in part without MMX’s prior written consent.

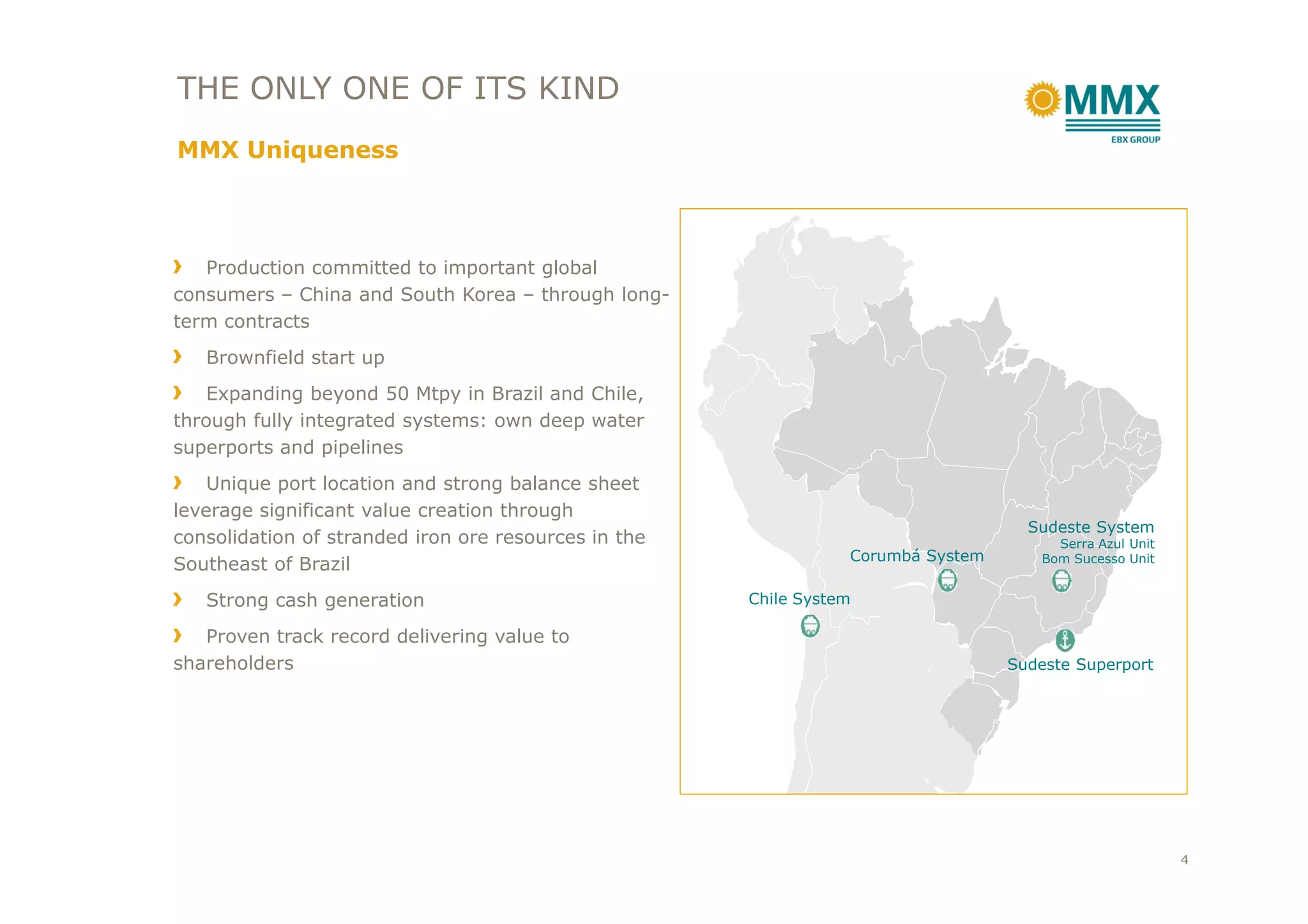

A UNIQUE STORY
1
THE ONLY ONE OF ITS KIND
MMX Uniqueness
Production committed to important global
consumers – China and South Korea – through long-
term contracts
Brownfield start up
Expanding beyond 50 Mtpy in Brazil and Chile,
through fully integrated systems: own deep water
superports and pipelines
Sudeste System
Serra Azul Unit
Bom Sucesso UnitCorumbá System
Sudeste Superport
Chile System
Unique port location and strong balance sheet
leverage significant value creation through
consolidation of stranded iron ore resources in the
Southeast of Brazil
Strong cash generation
Proven track record delivering value to
shareholders
4

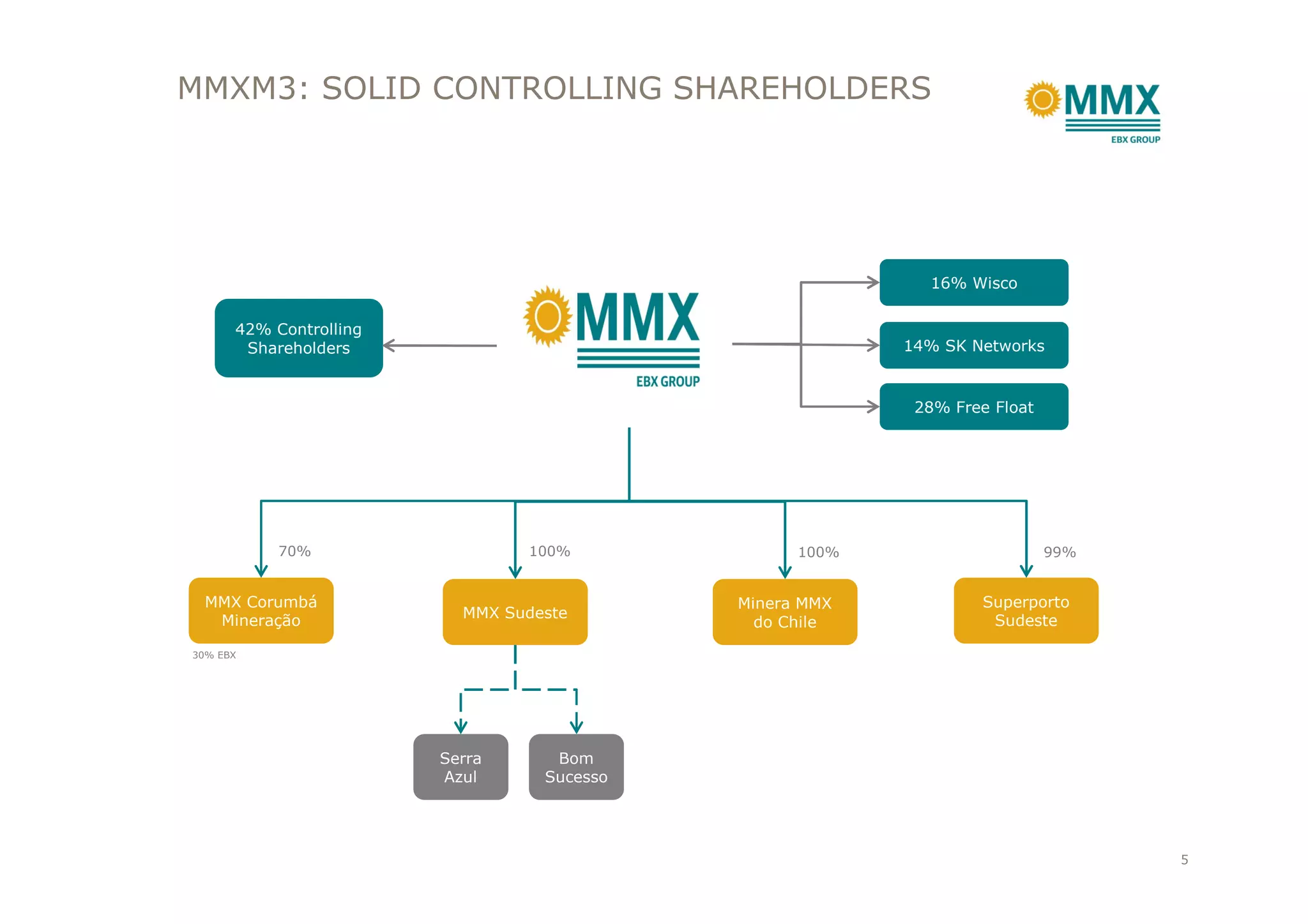

ESTRUTURA SOCIETÁRIA
42% Controlling
Shareholders
42% Controlling
Shareholders
16% Wisco16% Wisco
14% SK Networks14% SK Networks
28% Free Float28% Free Float
MMXM3: SOLID CONTROLLING SHAREHOLDERS
MMX Corumbá
Mineração
MMX Corumbá
Mineração
MMX SudesteMMX Sudeste
Minera MMX
do Chile
Minera MMX
do Chile
Superporto
Sudeste
Superporto
Sudeste
Serra
Azul
Serra
Azul
Bom
Sucesso
Bom
Sucesso
100% 100% 99%70%
30% EBX
5

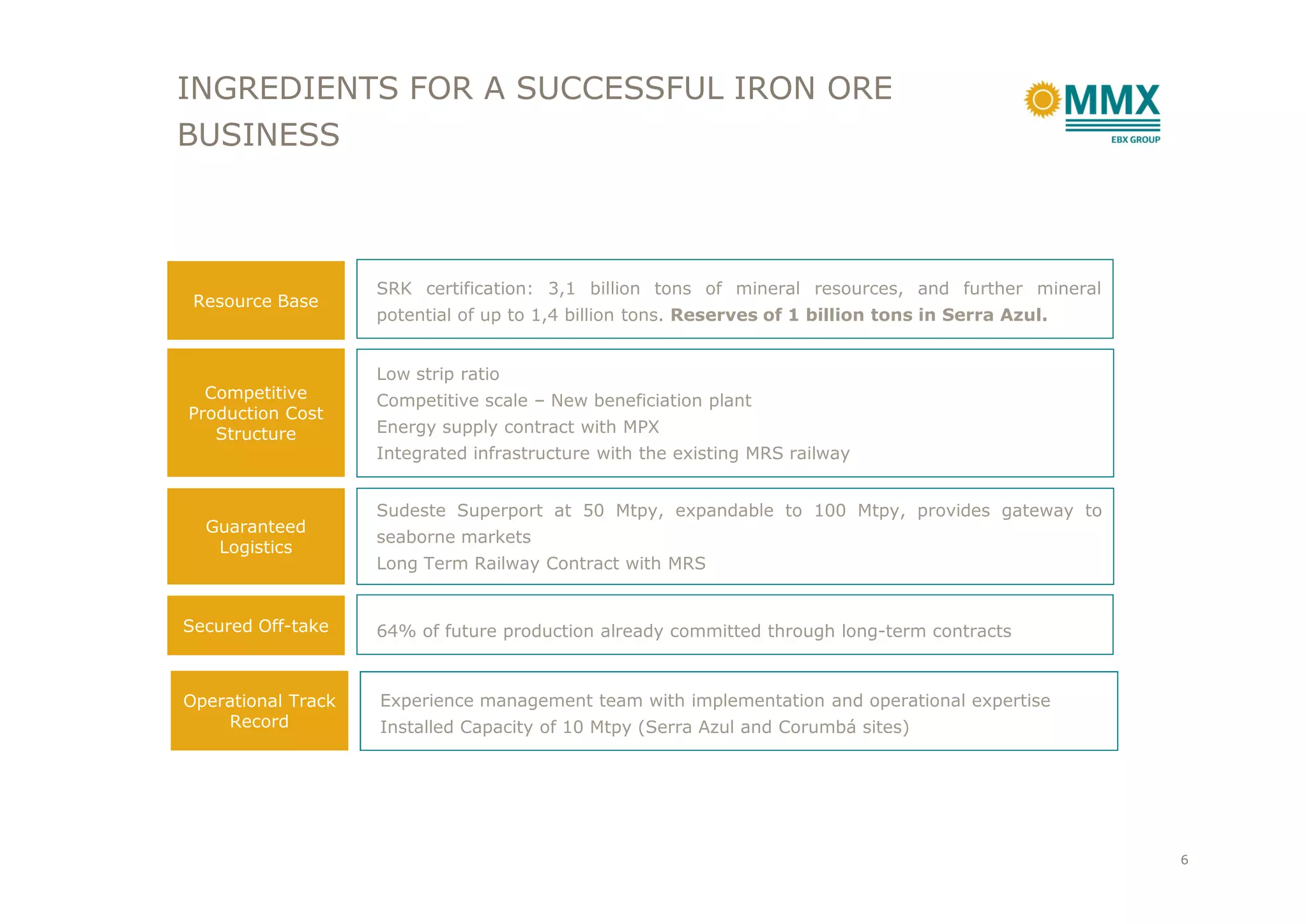

SRK certification: 3,1 billion tons of mineral resources, and further mineral
potential of up to 1,4 billion tons. Reserves of 1 billion tons in Serra Azul.
Low strip ratio
Competitive scale – New beneficiation plant
Energy supply contract with MPX
Integrated infrastructure with the existing MRS railway
Resource Base
Competitive
Production Cost
Structure
INGREDIENTS FOR A SUCCESSFUL IRON ORE
BUSINESS
64% of future production already committed through long-term contracts
Experience management team with implementation and operational expertise
Installed Capacity of 10 Mtpy (Serra Azul and Corumbá sites)
Sudeste Superport at 50 Mtpy, expandable to 100 Mtpy, provides gateway to
seaborne markets
Long Term Railway Contract with MRS
Integrated infrastructure with the existing MRS railway
Secured Off-take
Operational Track
Record
Guaranteed
Logistics
6

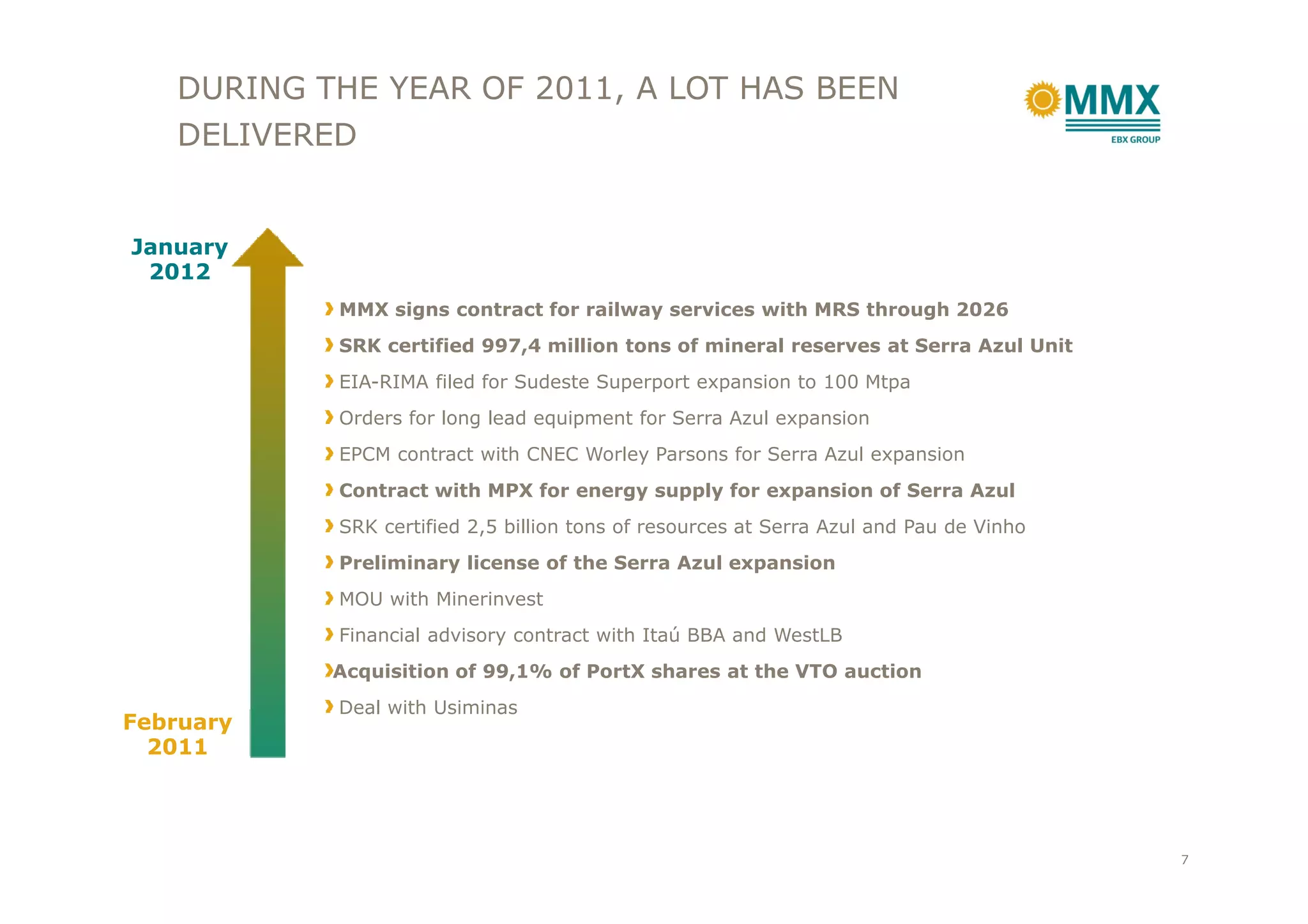

MMX signs contract for railway services with MRS through 2026
SRK certified 997,4 million tons of mineral reserves at Serra Azul Unit
EIA-RIMA filed for Sudeste Superport expansion to 100 Mtpa
Orders for long lead equipment for Serra Azul expansion
EPCM contract with CNEC Worley Parsons for Serra Azul expansion
January
2012
DURING THE YEAR OF 2011, A LOT HAS BEEN
DELIVERED
EPCM contract with CNEC Worley Parsons for Serra Azul expansion
Contract with MPX for energy supply for expansion of Serra Azul
SRK certified 2,5 billion tons of resources at Serra Azul and Pau de Vinho
Preliminary license of the Serra Azul expansion
MOU with Minerinvest
Financial advisory contract with Itaú BBA and WestLB
Acquisition of 99,1% of PortX shares at the VTO auction
Deal with Usiminas
February
2011
7
FINANCIAL HIGHLIGHTS
72.8
75.2
61.6
0
30
60
90
3Q10 2Q11 3Q11*
EBITDA (R$ million)
88.5 90.9
(243.2)
-250
-150
-50
50
3Q10 2Q11 3Q11
Net Profit (R$ million)
*excluding non recurent itens
46%
37%
27%
54%
63%
73%
0%
50%
100%
3Q10 2Q11 3Q11
Debt profile
Short Term Long Term
1,1
1,3 1,5
0,6
0,8
0,7
0,0
1,0
2,0
3Q10 2Q11 3Q11
Sales (million ton)
Domestic Market Seaborne Market
8
SUDESTE SYSTEM
2

UNIQUE INTEGRATED LOGISTICS
Since Iron ore is a bulk commodity, an integrated logistic (mine
railway port) is the key factor for a successful operation
Mine SuperportRailway
Serra Azul unit is near to the
MRS railway - 10 km from the
mine, a distance currently
traversed by trucks.
MMX has a long term contract
with MRS railway, which connects
the mine with the CSN’s Itaguaí
port and to the Sudeste
Superport.
Sudeste Superport is located in
Itaguaí and will have 50Mtpy iron
ore shipping capacity. The Superport
will have a depth of 20 meters,
enough to handle Capesize vessels.
Offtakers (Shareholders)
Long-Term contract (20 years) to trade iron
ore. SK will take-off part of the Sudeste
System yearly production equivalent to its
participation in MMX Capital (14%).
SK and Wisco will together
offtake 64% of total production
Long-Term contract (20 years). Wisco will
off-take at least 50% of MMX Sudeste
production.
10
SERRA AZUL UNIT
2.1

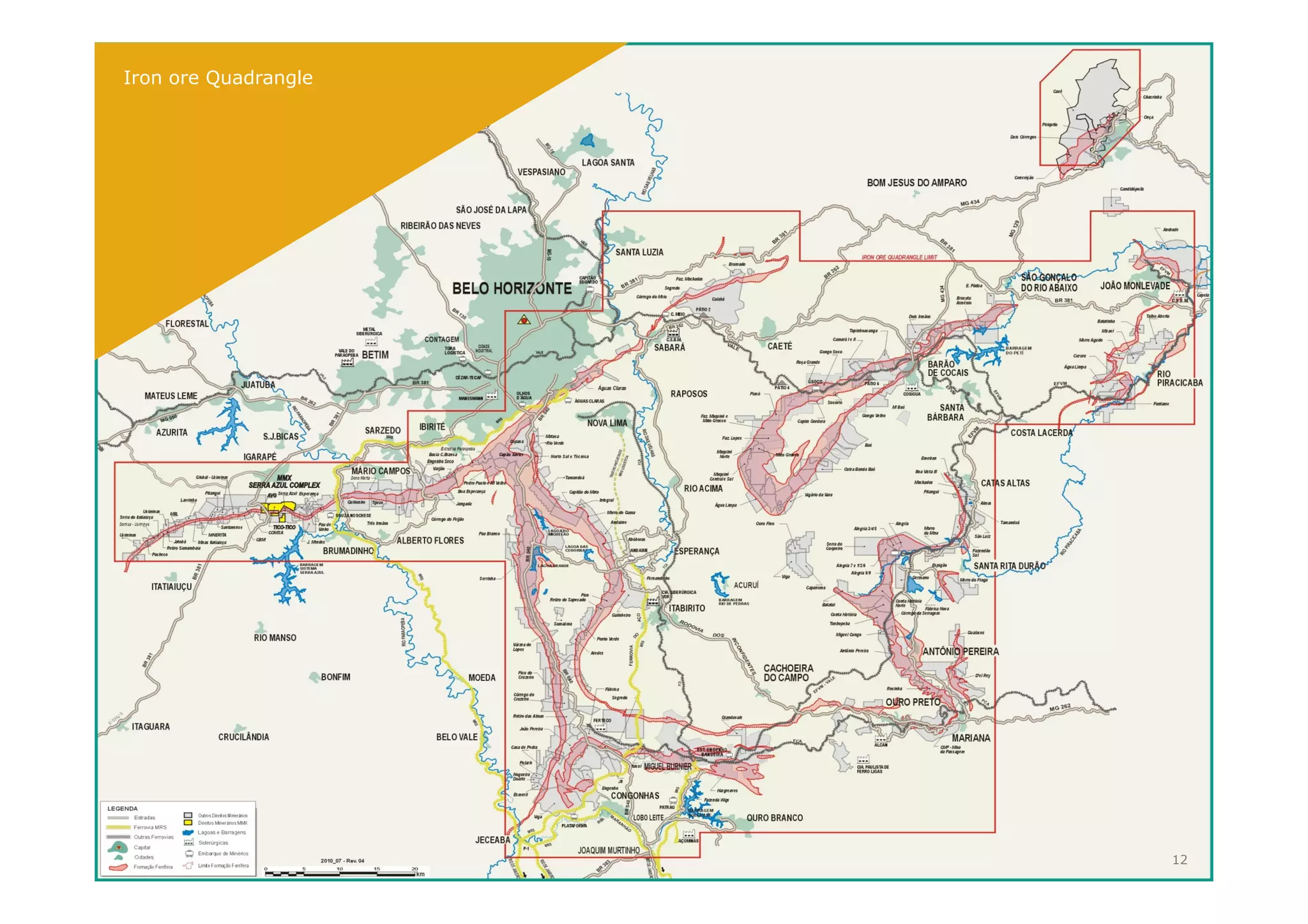

QUADRILÁTERO FERRÍFEROIron ore Quadrangle
12

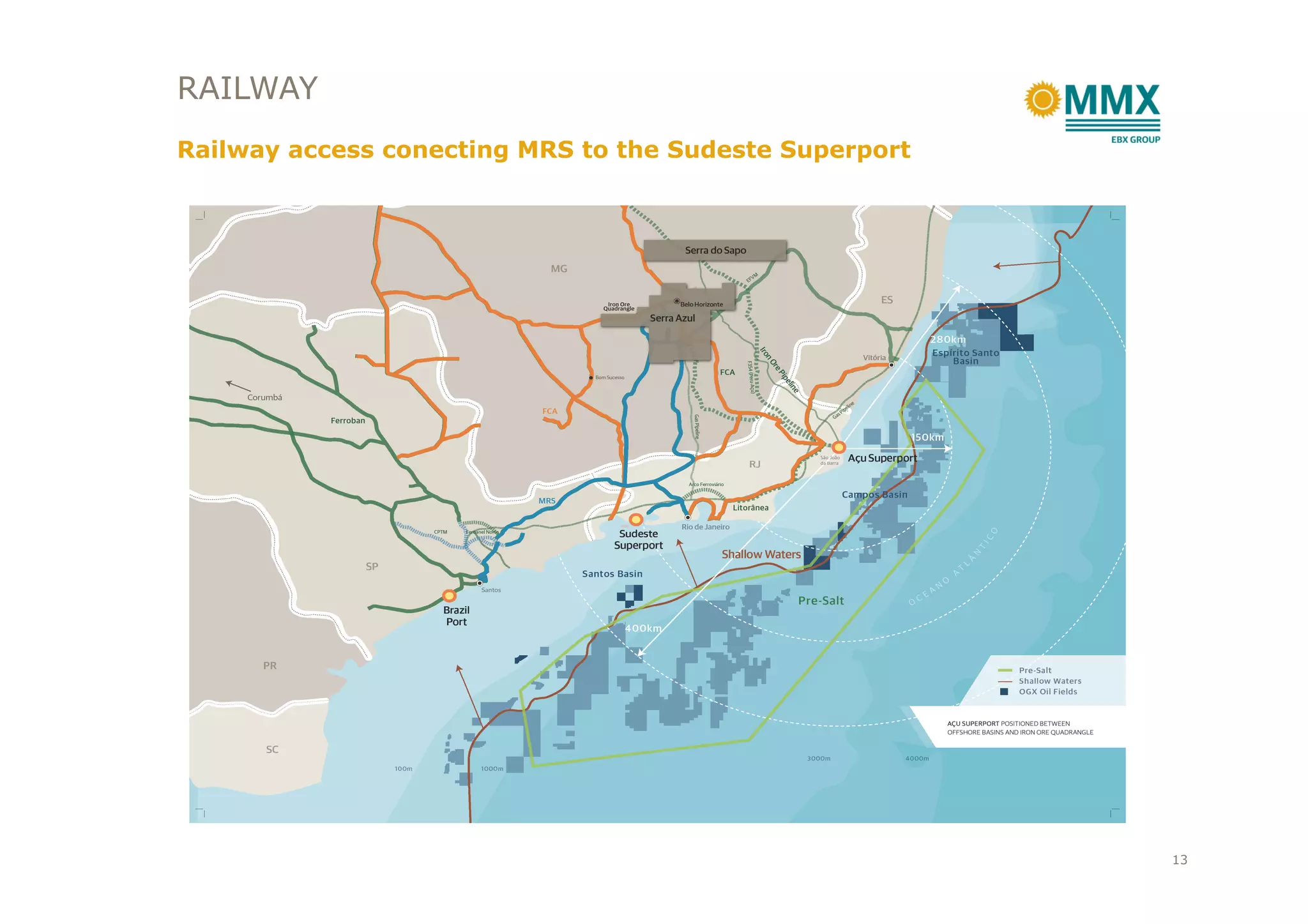

RAILWAY
Railway access conecting MRS to the Sudeste Superport
13

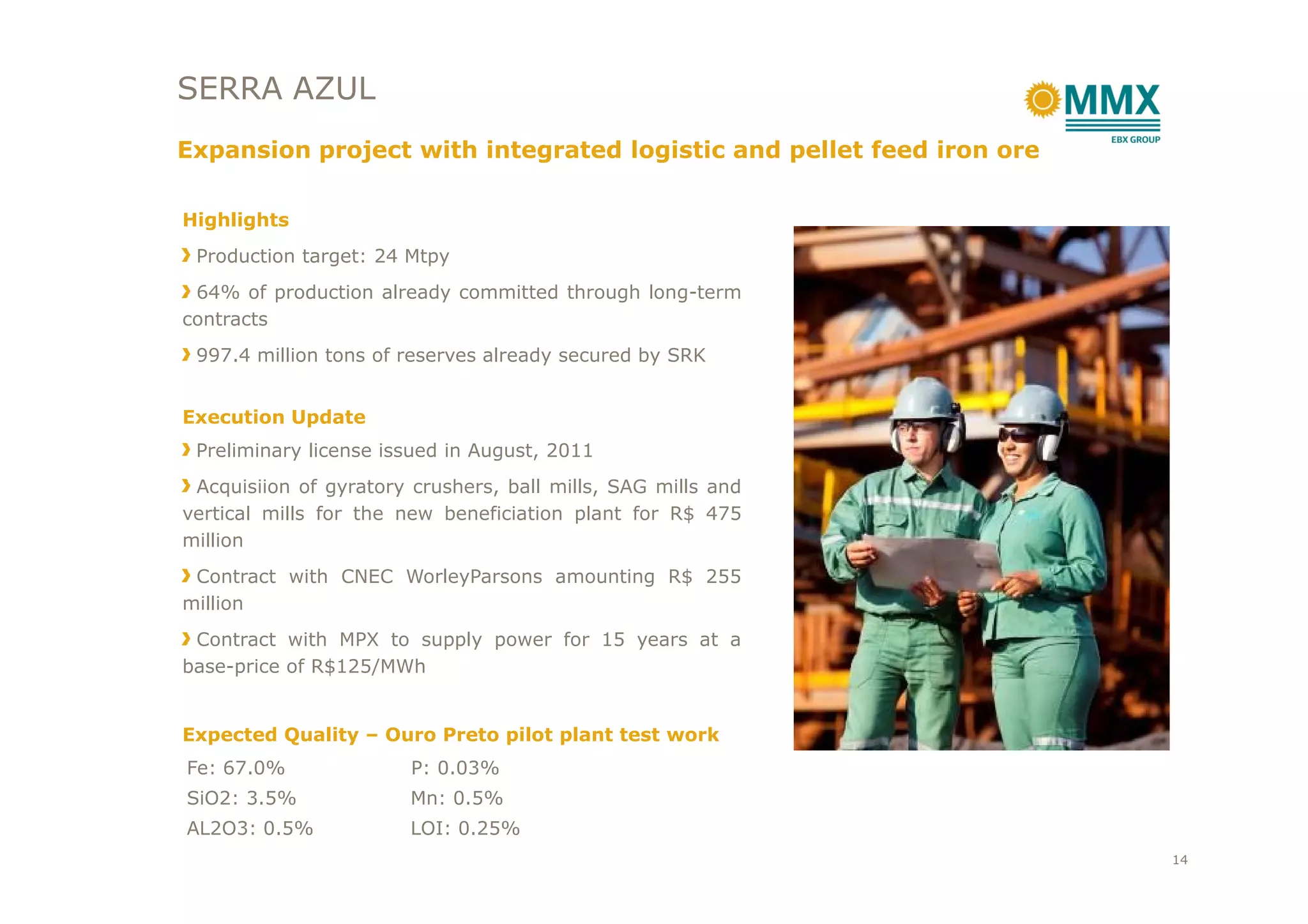

SERRA AZUL
Expansion project with integrated logistic and pellet feed iron ore
Highlights
Production target: 24 Mtpy
64% of production already committed through long-term
contracts
997.4 million tons of reserves already secured by SRK
Execution Update
Preliminary license issued in August, 2011
Acquisiion of gyratory crushers, ball mills, SAG mills and
vertical mills for the new beneficiation plant for R$ 475
million
Contract with CNEC WorleyParsons amounting R$ 255
million
Contract with MPX to supply power for 15 years at a
base-price of R$125/MWh
Expected Quality – Ouro Preto pilot plant test work
Fe: 67.0% P: 0.03%
SiO2: 3.5% Mn: 0.5%
AL2O3: 0.5% LOI: 0.25%
14
SERRA AZUL
Growth through consolidation while leveraging existing
infrastructure
15

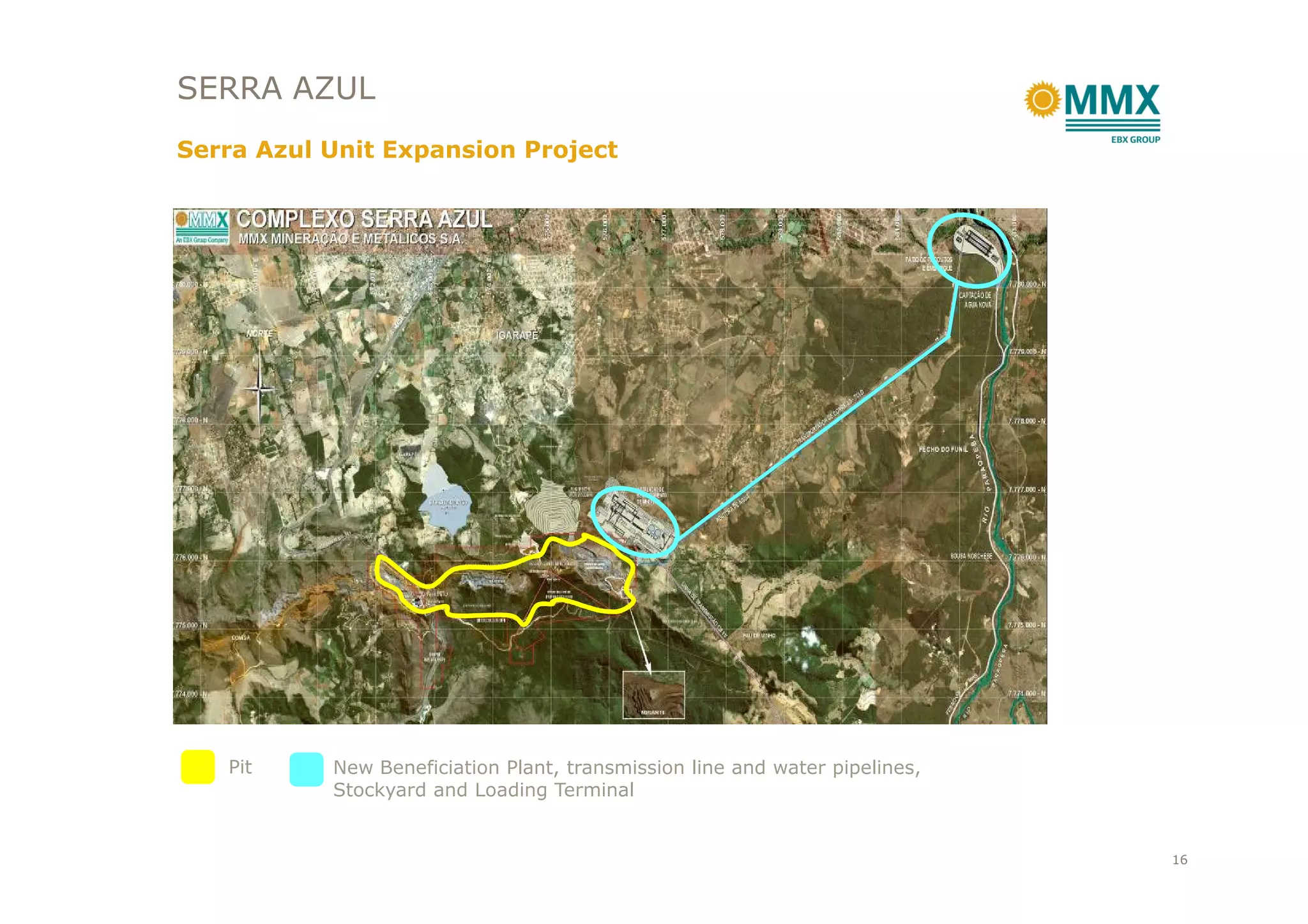

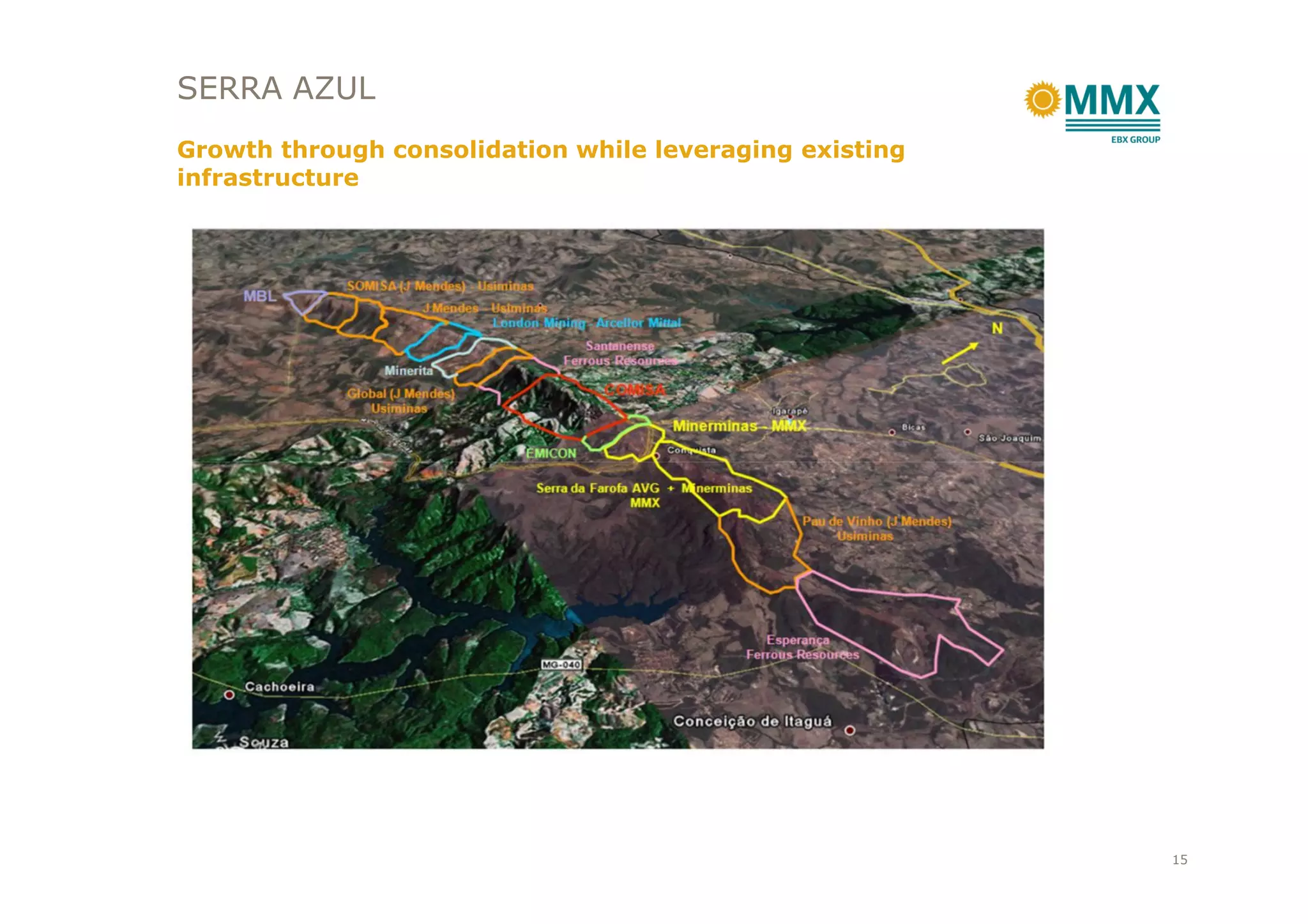

SERRA AZUL
Serra Azul Unit Expansion Project
New Beneficiation Plant, transmission line and water pipelines,
Stockyard and Loading Terminal
Pit
16
Serra Azul Expansion
Beneficiation Plant
17

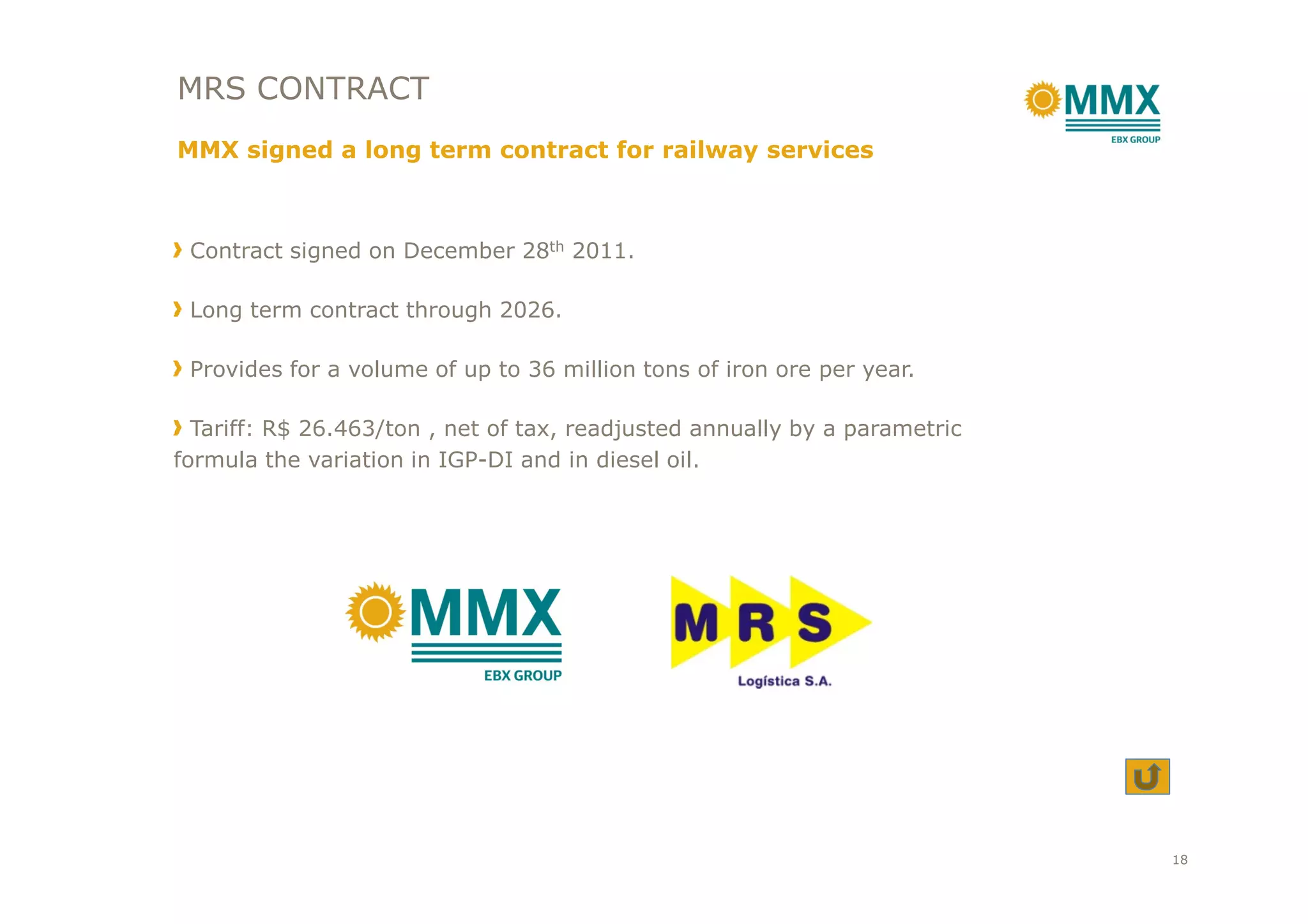

Contract signed on December 28th 2011.
Long term contract through 2026.
Provides for a volume of up to 36 million tons of iron ore per year.
Tariff: R$ 26.463/ton , net of tax, readjusted annually by a parametric
formula the variation in IGP-DI and in diesel oil.
MRS CONTRACT
MMX signed a long term contract for railway services
formula the variation in IGP-DI and in diesel oil.
18
SUDESTE SUPERPORT
2.2

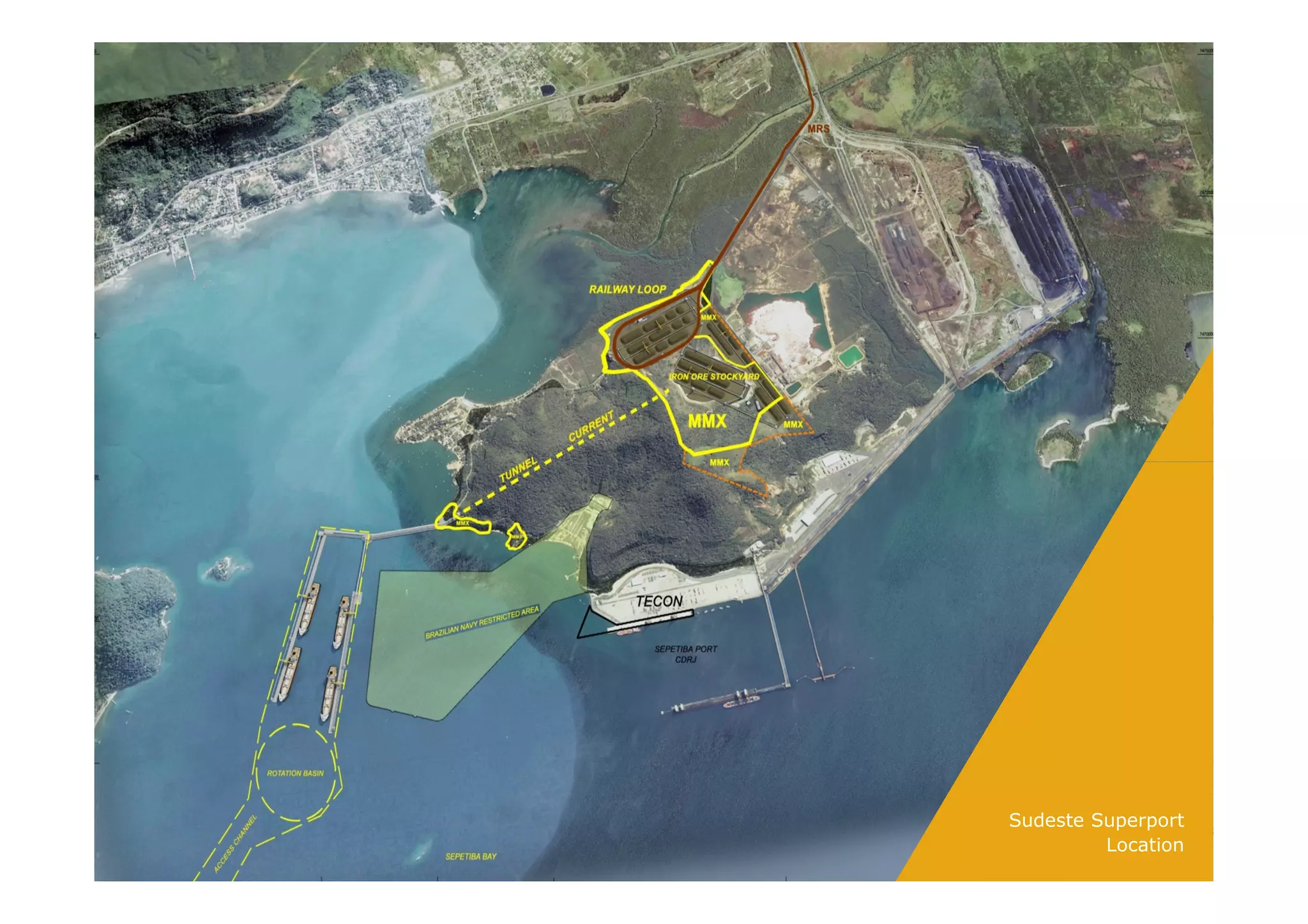

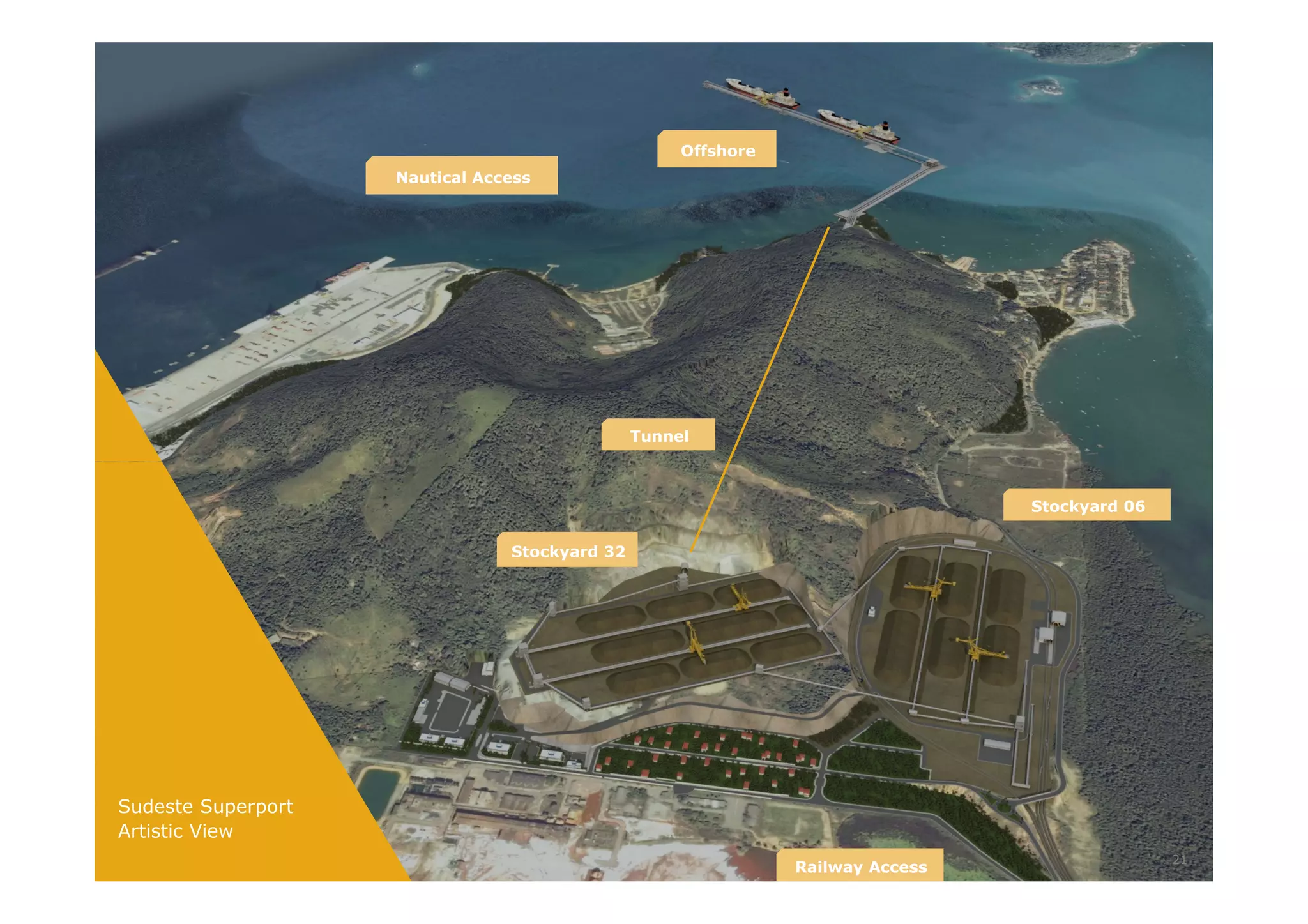

Sudeste Superport
Location
Nautical Access
Offshore
Tunnel
Stockyard 32
Stockyard 06
Railway Access
Sudeste Superport
Artistic View
21

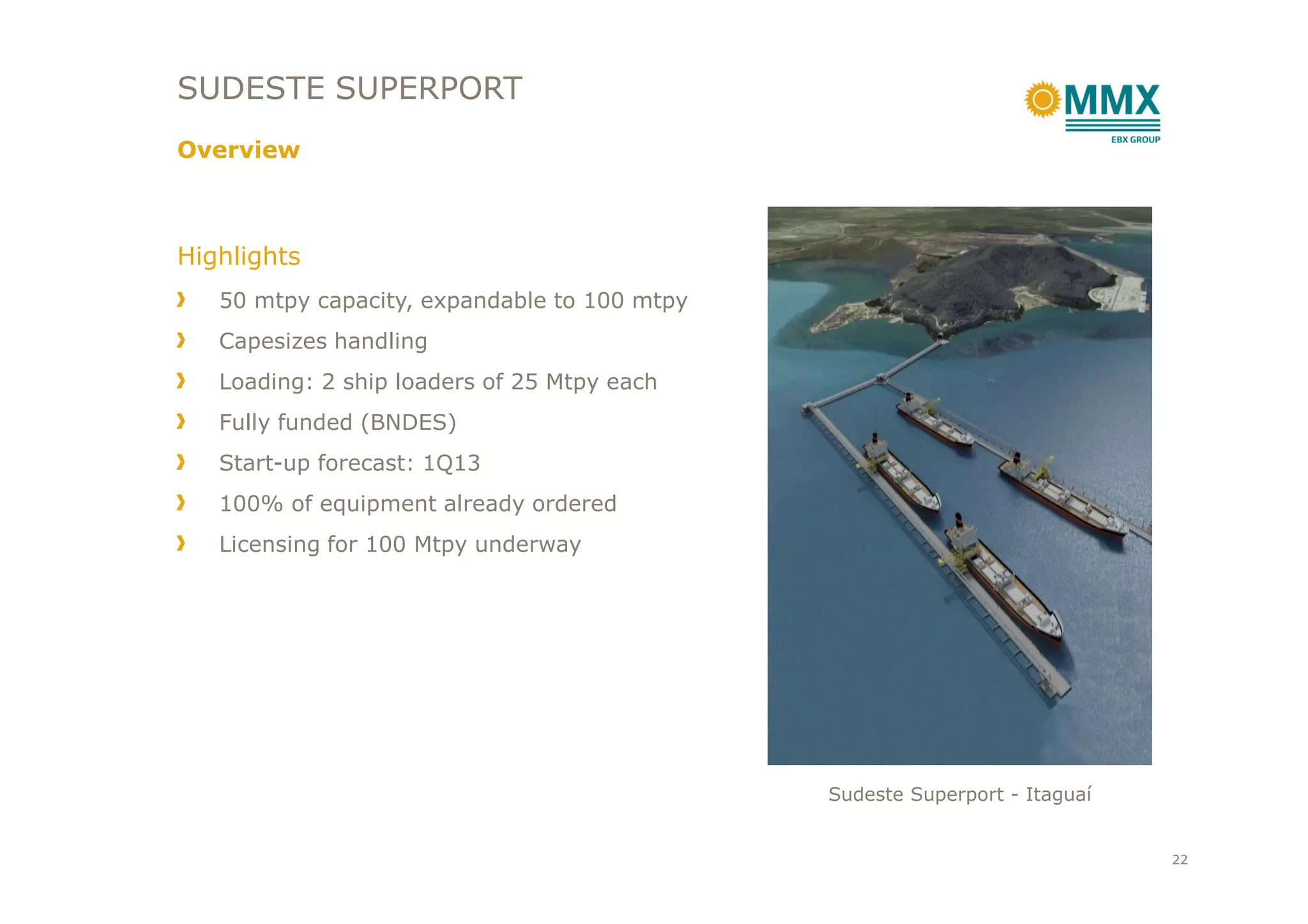

SUDESTE SUPERPORT
Overview
Highlights
50 mtpy capacity, expandable to 100 mtpy
Capesizes handling
Loading: 2 ship loaders of 25 Mtpy each
Fully funded (BNDES)
Start-up forecast: 1Q13
Sudeste Superport - Itaguaí
Start-up forecast: 1Q13
100% of equipment already ordered
Licensing for 100 Mtpy underway
22

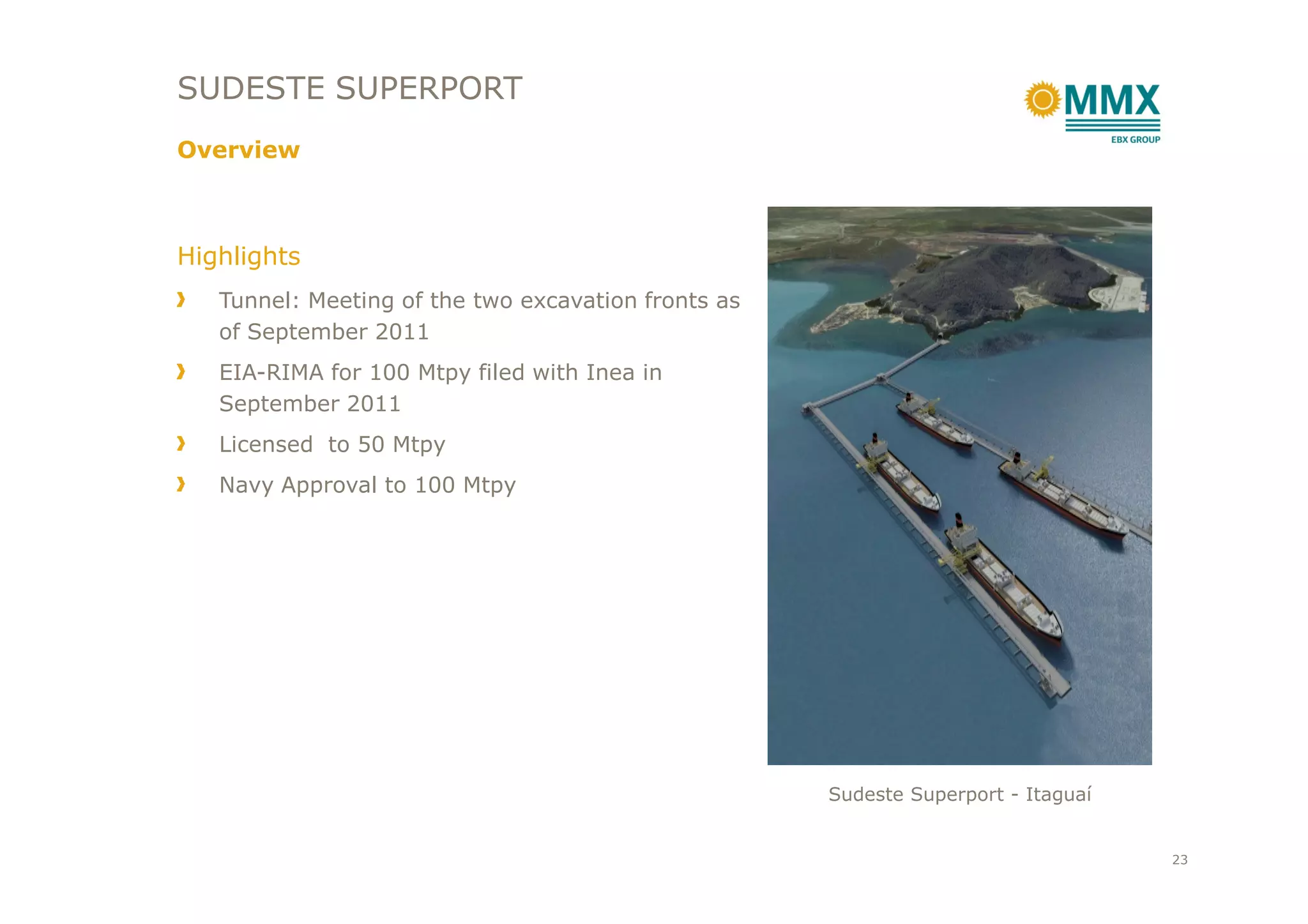

SUDESTE SUPERPORT
Overview
Highlights
Tunnel: Meeting of the two excavation fronts as
of September 2011
EIA-RIMA for 100 Mtpy filed with Inea in
September 2011
Licensed to 50 Mtpy
Sudeste Superport - Itaguaí
Navy Approval to 100 Mtpy
23
Sudeste Superport
Railway access

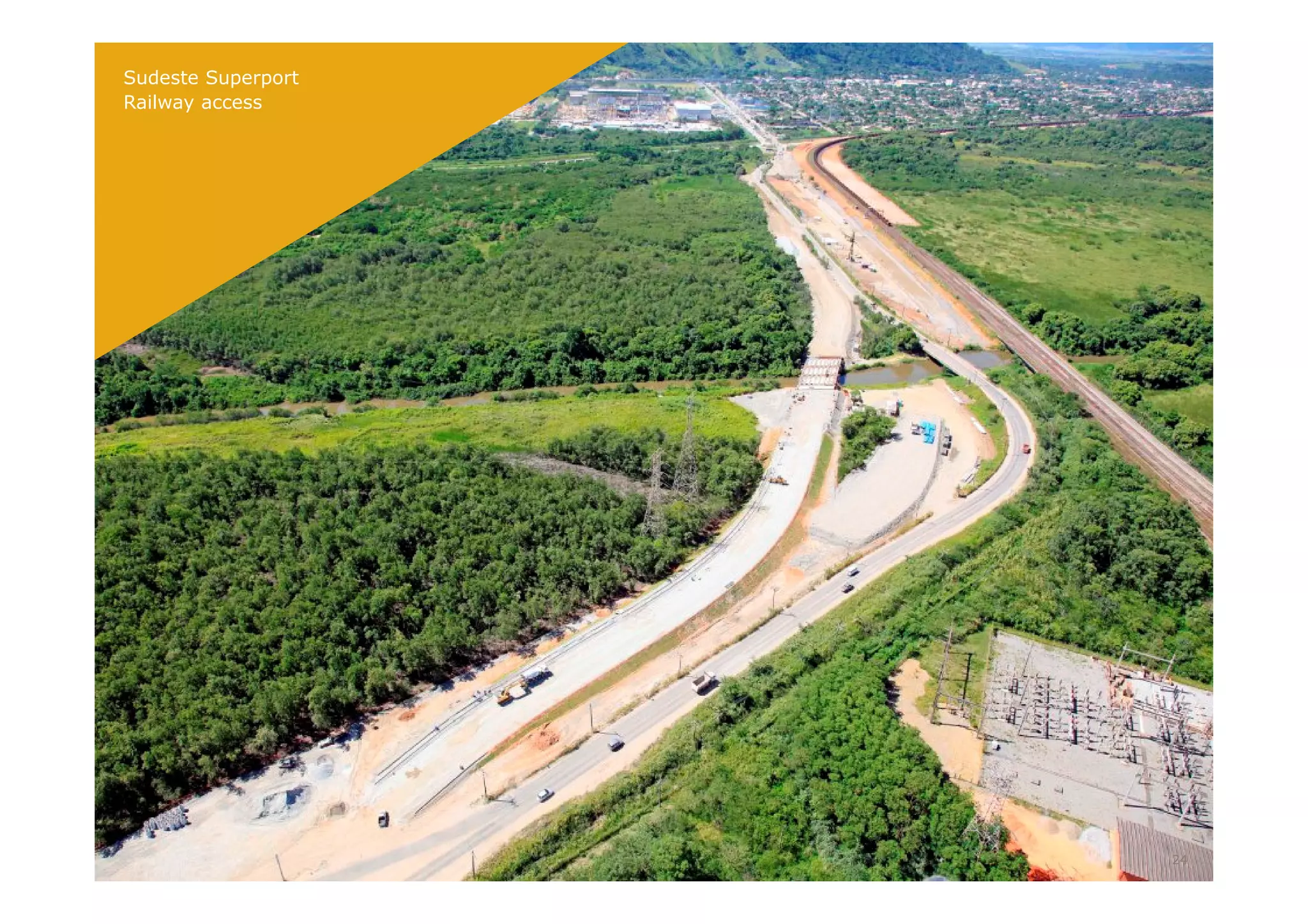

24

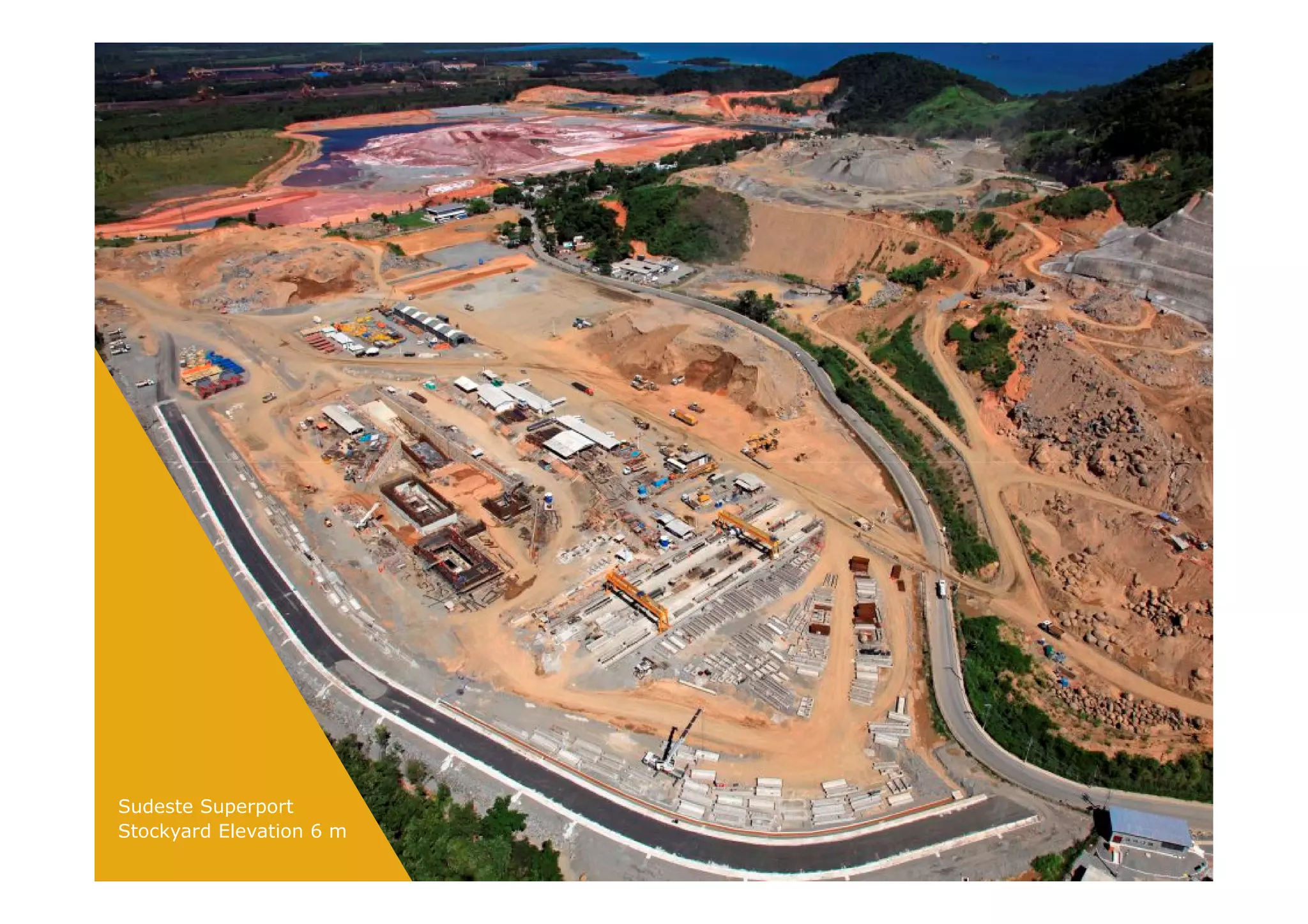

Sudeste Superport
Stockyard Elevation 6 m
25

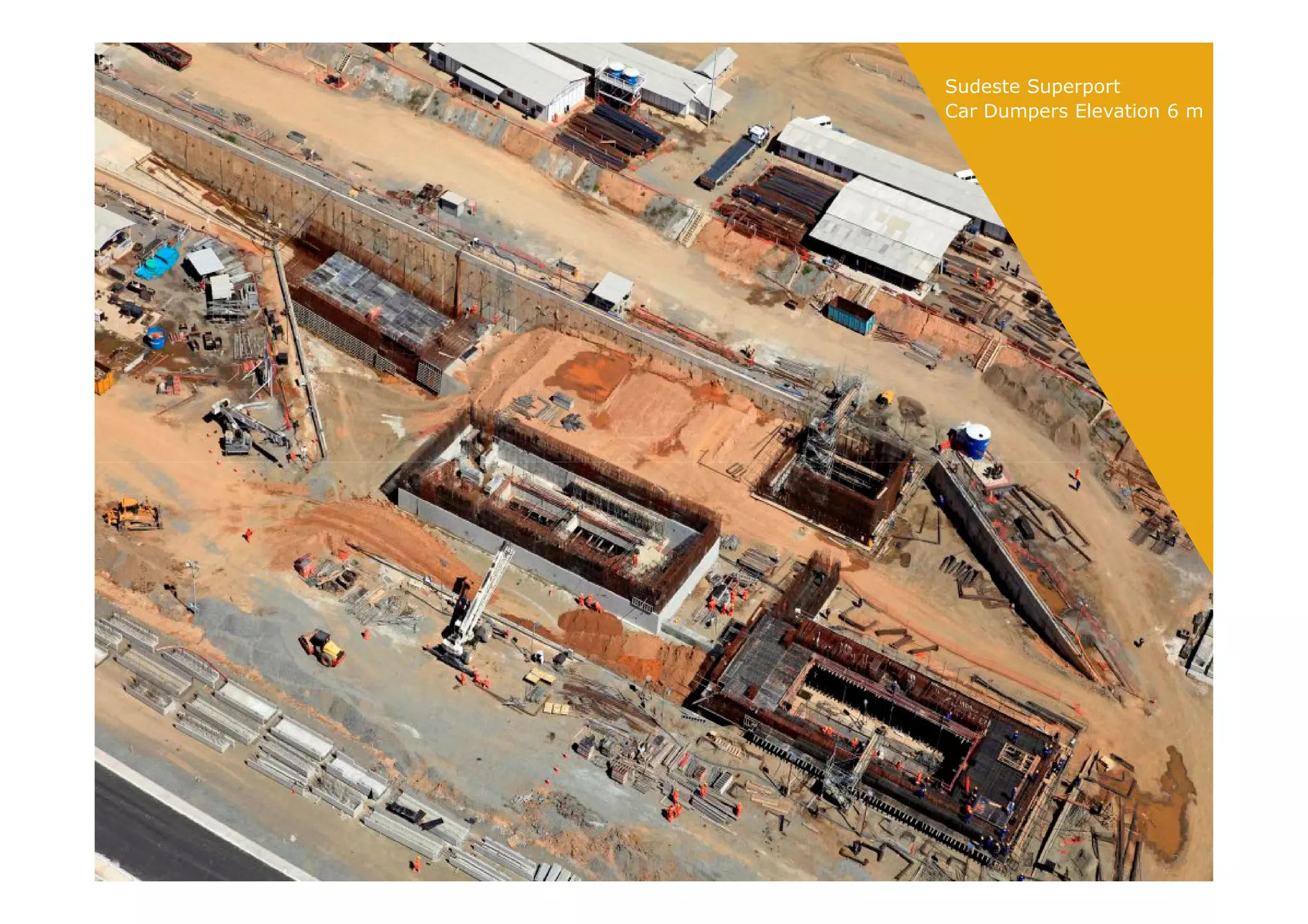

Sudeste Superport
Car Dumpers Elevation 6 m
26

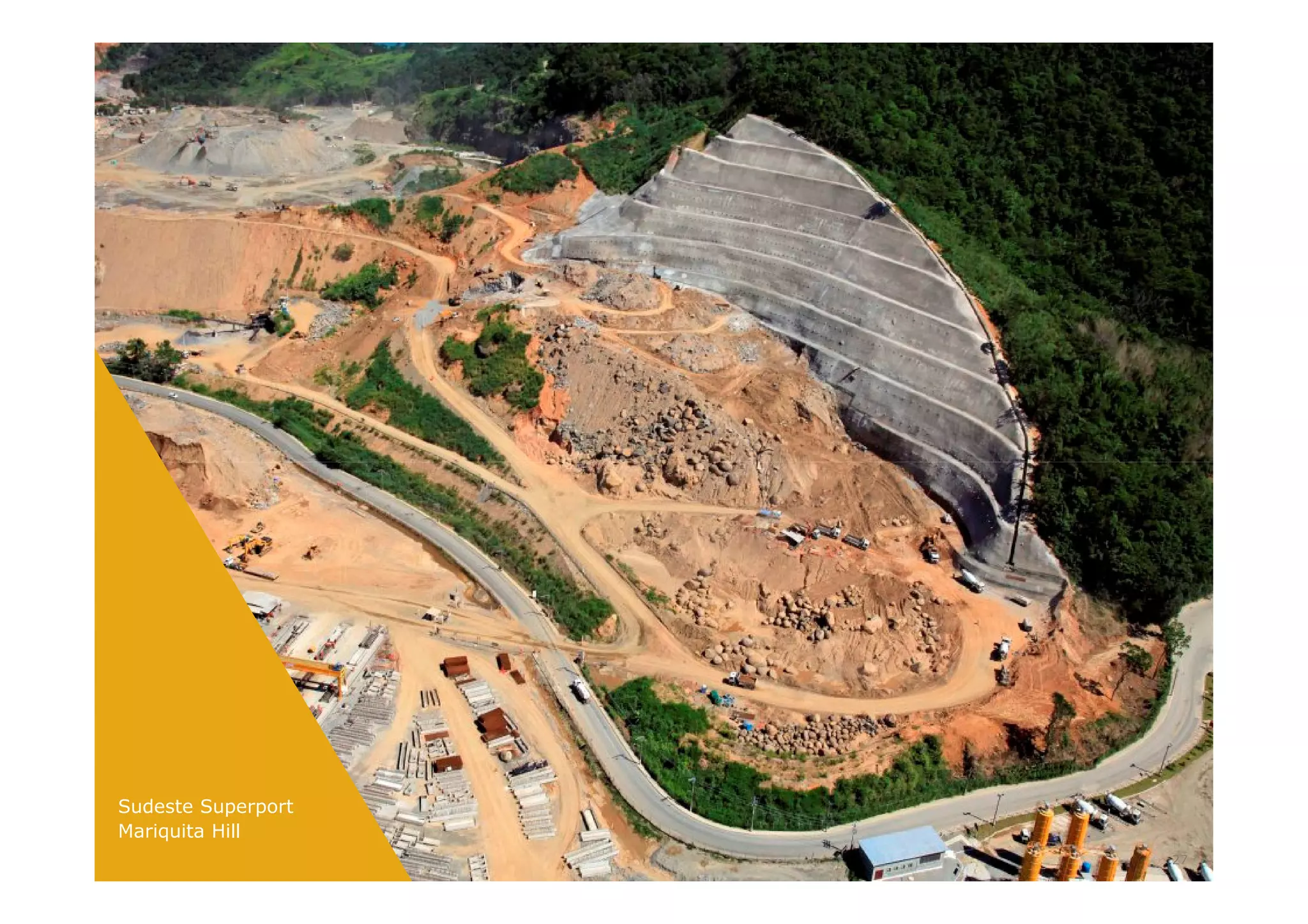

Sudeste Superport
Mariquita Hill
27
Sudeste Superport

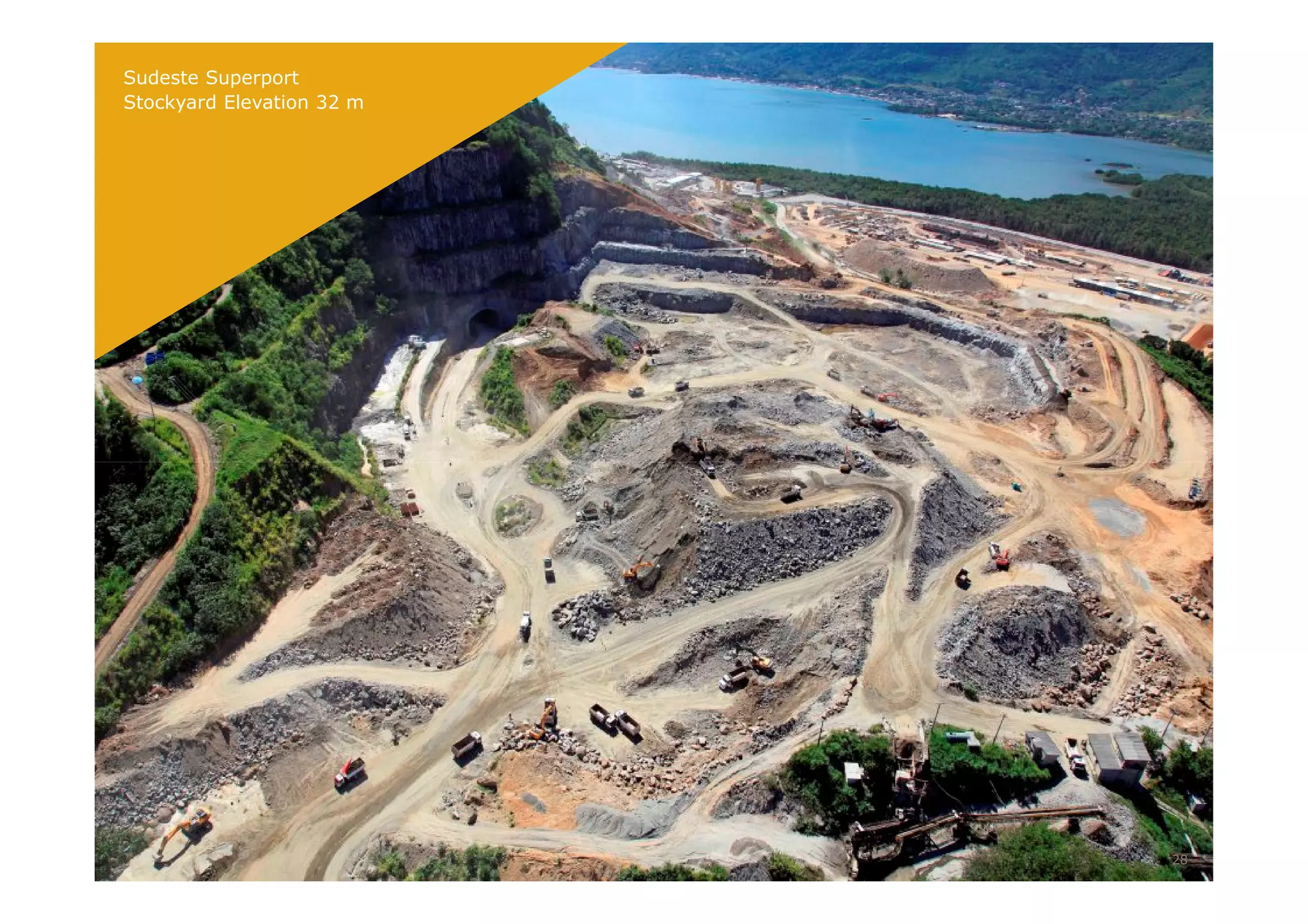

Stockyard Elevation 32 m
28

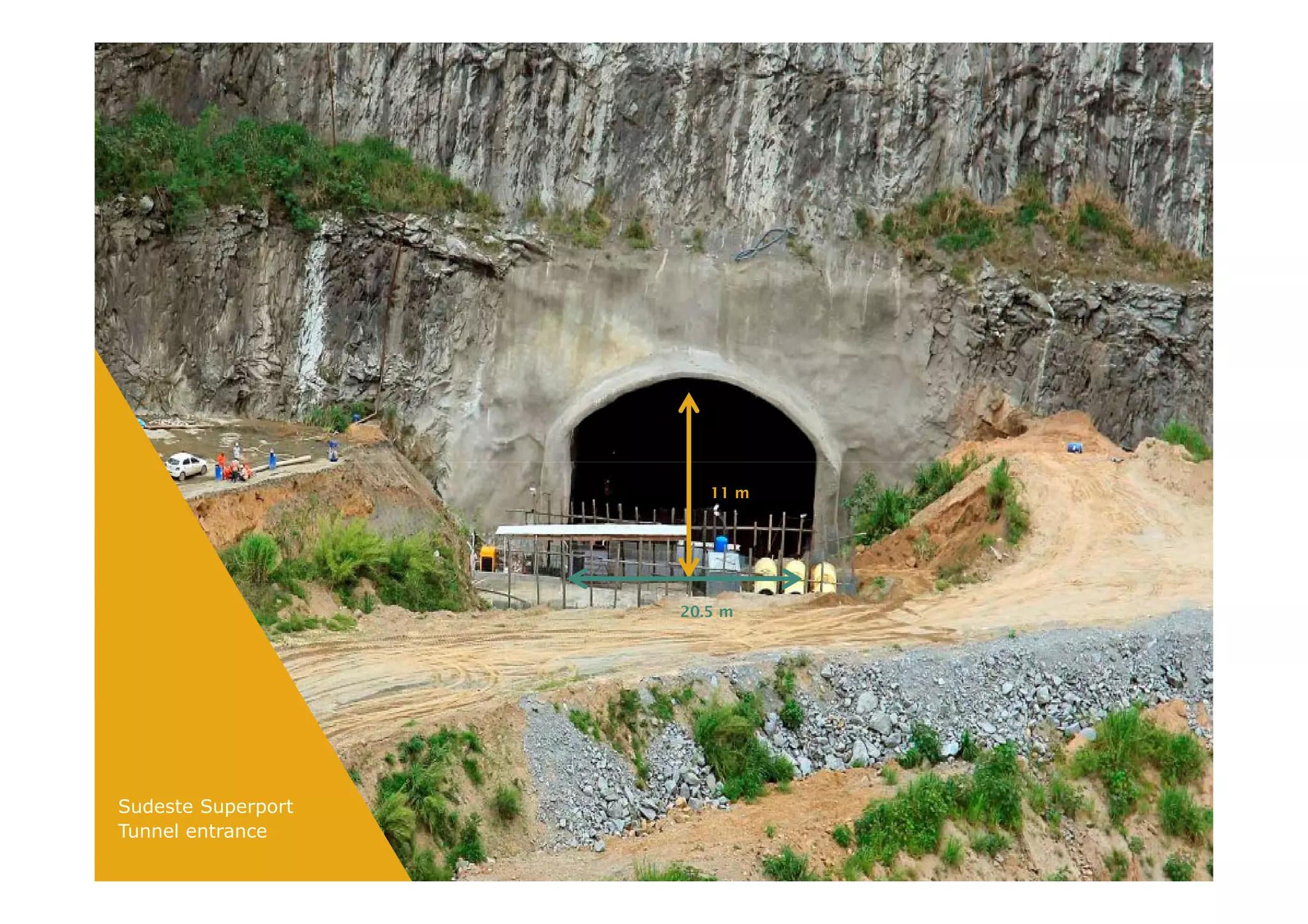

11 m
20.5 m
Sudeste Superport
Tunnel entrance
29

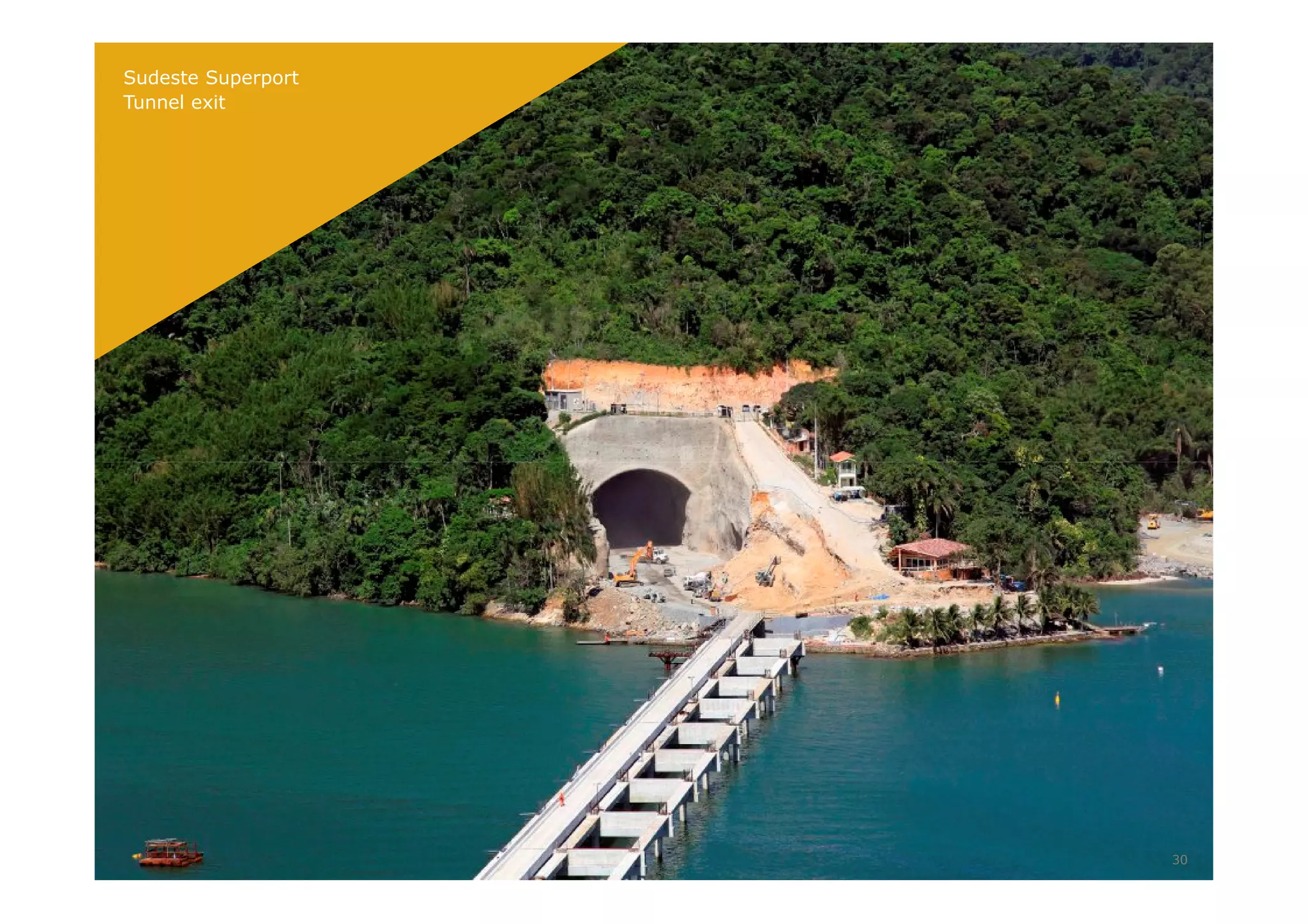

Sudeste Superport
Tunnel exit
30

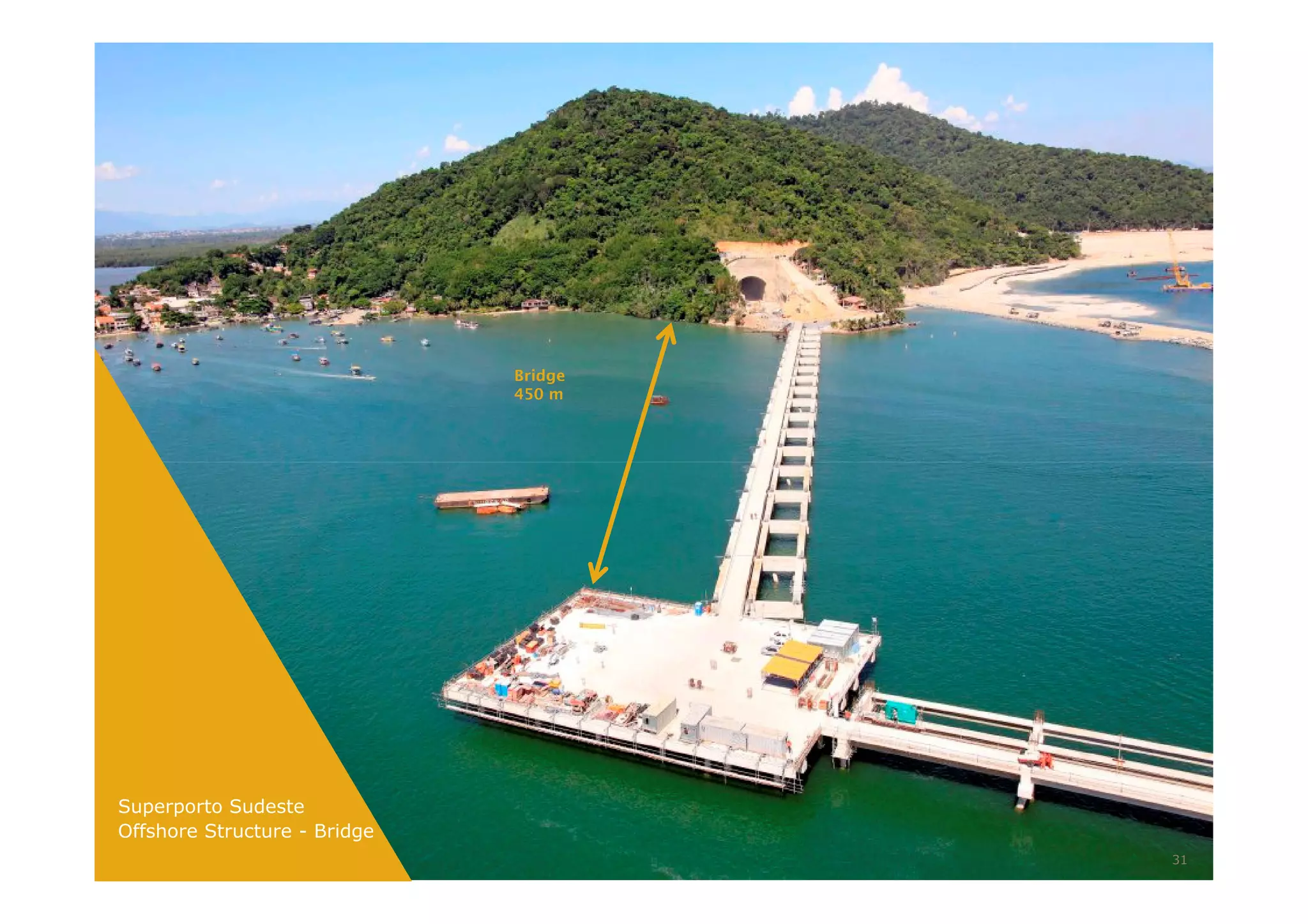

Bridge
450 m
Superporto Sudeste
Offshore Structure - Bridge
31

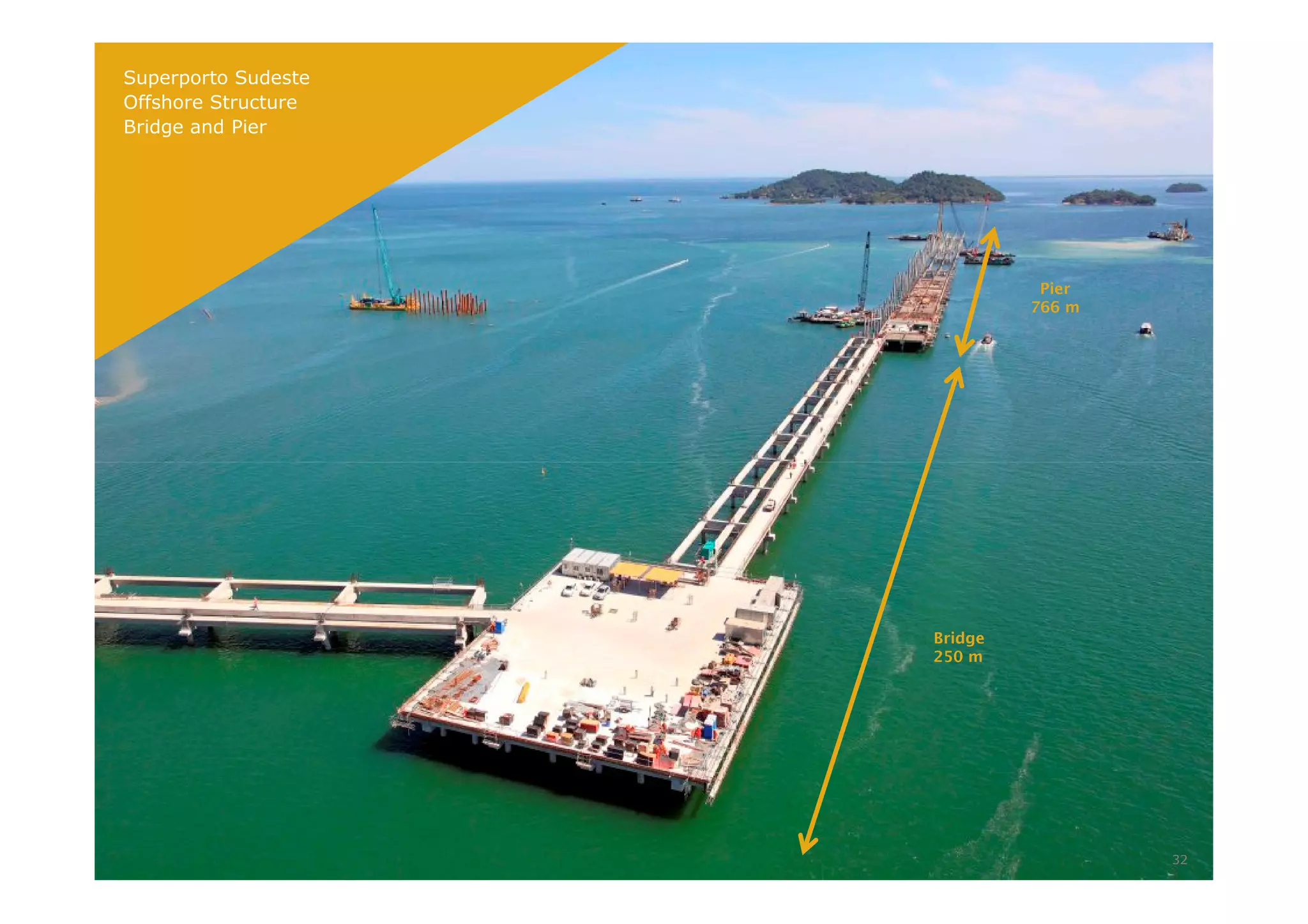

Pier
766 m
Superporto Sudeste
Offshore Structure
Bridge and Pier
Bridge
250 m
32
33

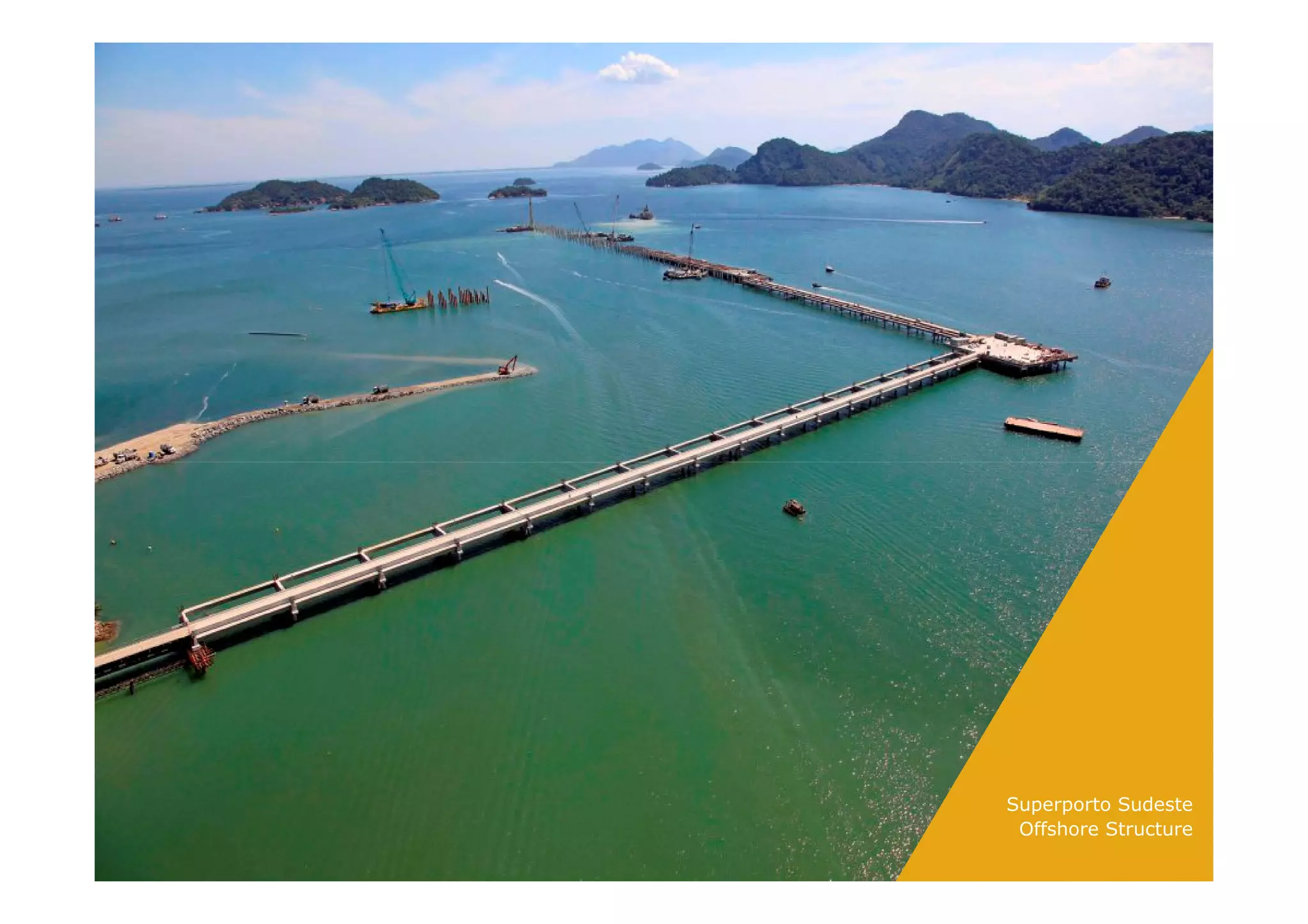

Superporto Sudeste
Offshore Structure

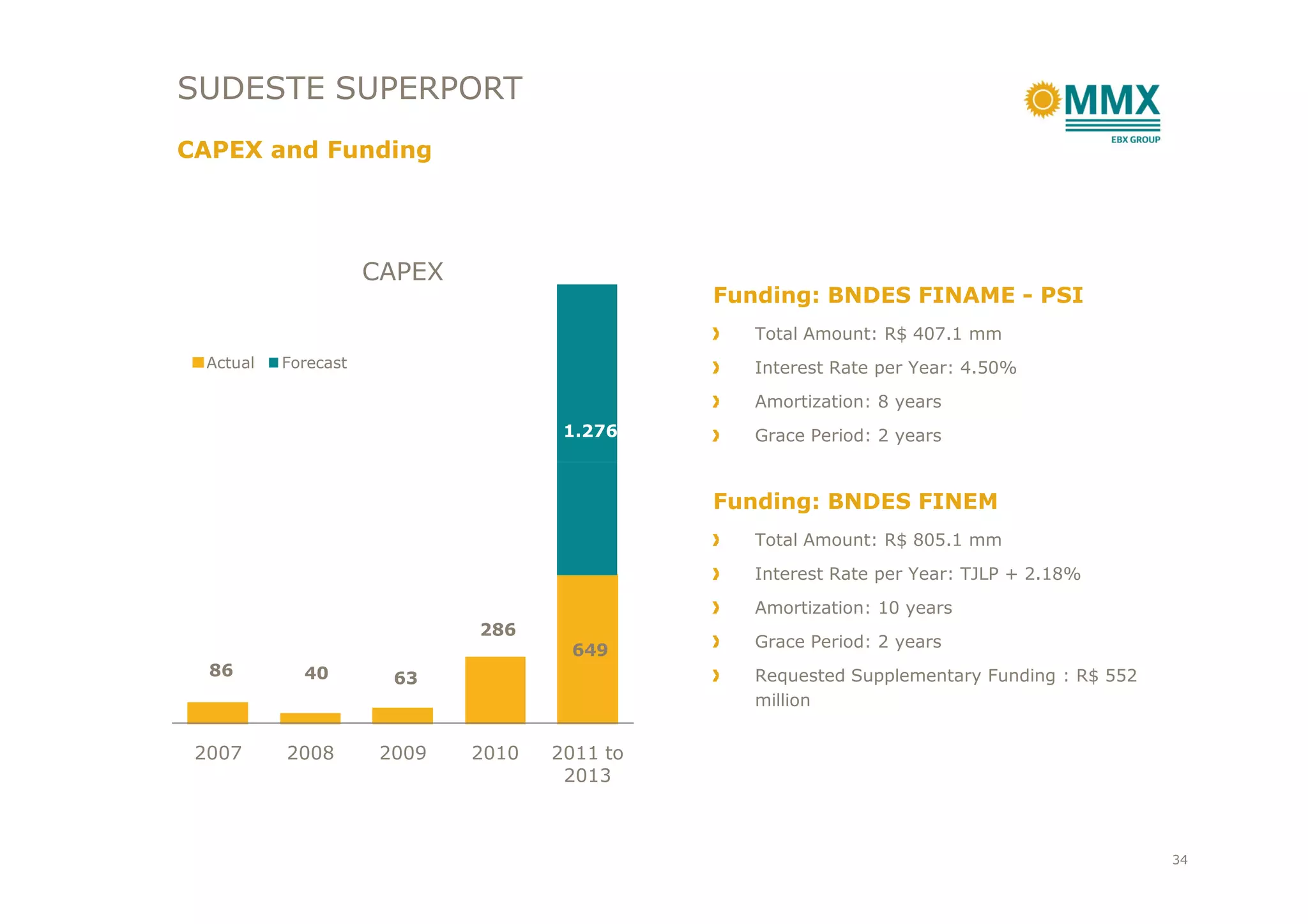

Funding: BNDES FINAME - PSI
Total Amount: R$ 407.1 mm
Interest Rate per Year: 4.50%
Amortization: 8 years
Grace Period: 2 years1.276
CAPEX
Actual Forecast
SUDESTE SUPERPORT
CAPEX and Funding
Funding: BNDES FINEM
Total Amount: R$ 805.1 mm
Interest Rate per Year: TJLP + 2.18%
Amortization: 10 years
Grace Period: 2 years
Requested Supplementary Funding : R$ 552
million
86 40 63
286
649
2007 2008 2009 2010 2011 to
2013
34

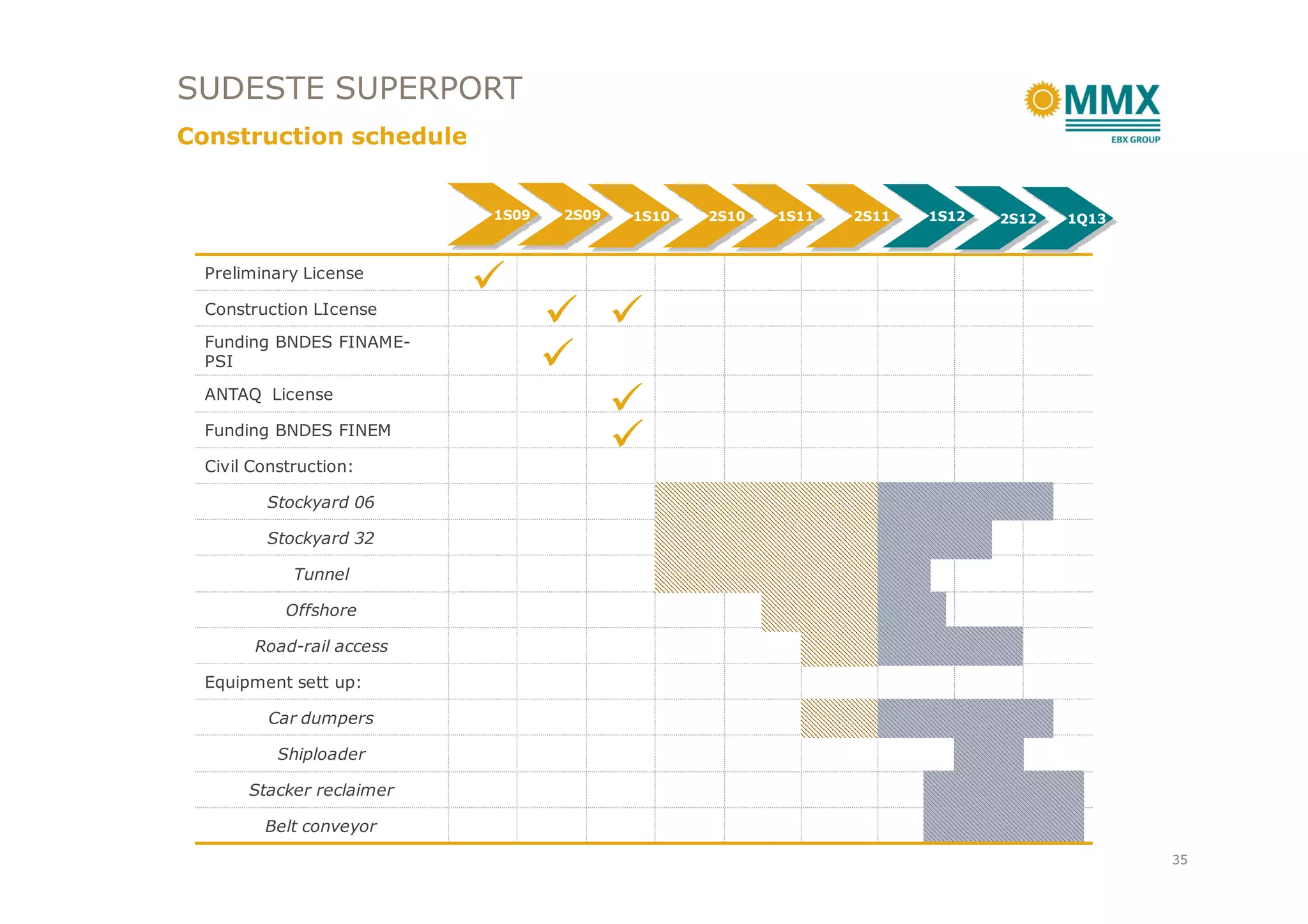

SUDESTE SUPERPORT
Construction schedule
Preliminary License
Construction LIcense
Funding BNDES FINAME-
PSI
ANTAQ License
Funding BNDES FINEM
Civil Construction:
1S09 2S09 1S10 2S10 1S11 2S11 1S12 2S12 1Q13
Civil Construction:
Stockyard 06
Stockyard 32
Tunnel
Offshore
Road-rail access
Equipment sett up:
Car dumpers
Shiploader
Stacker reclaimer
Belt conveyor
35

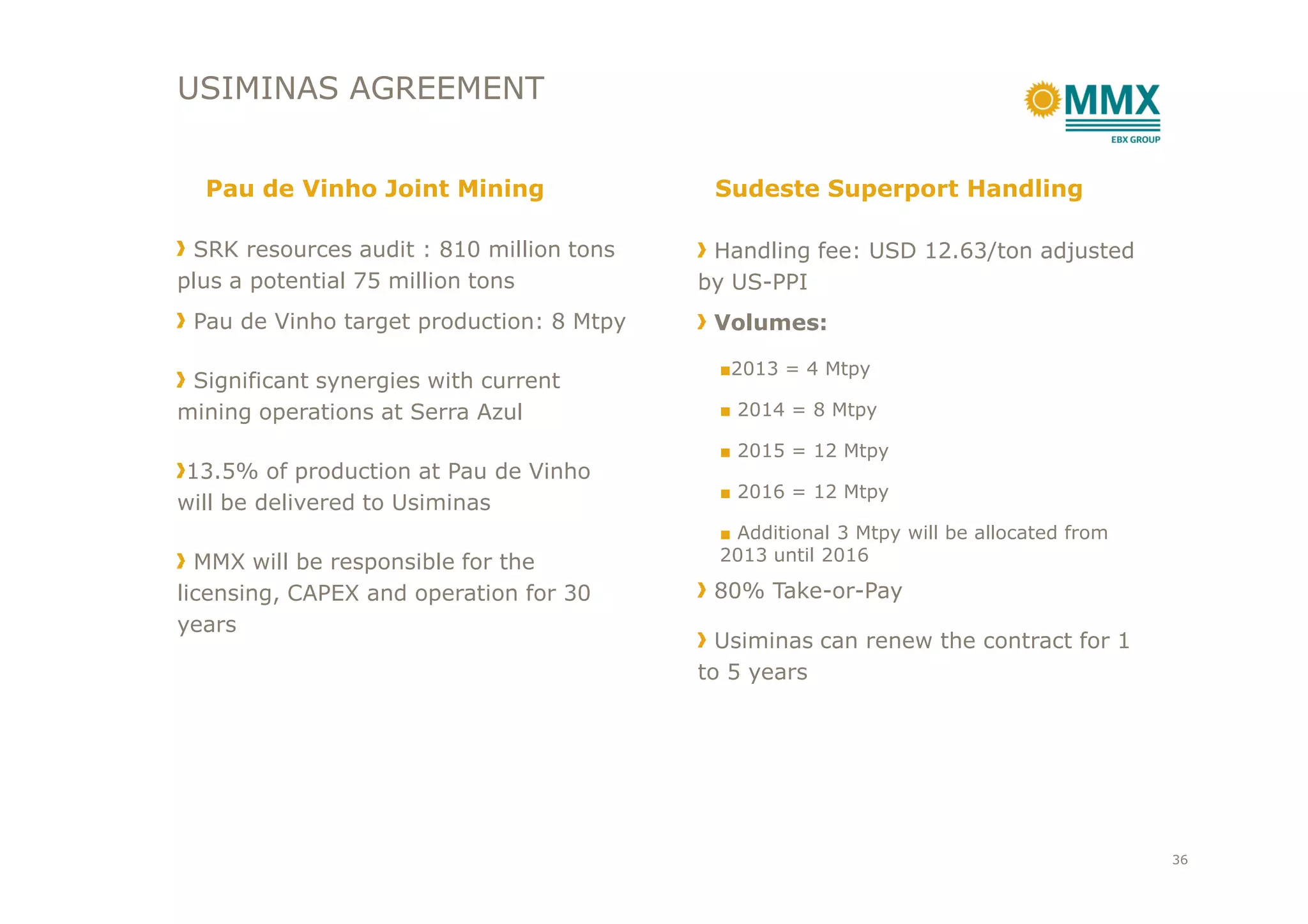

USIMINAS AGREEMENT
SRK resources audit : 810 million tons
plus a potential 75 million tons
Pau de Vinho target production: 8 Mtpy
Significant synergies with current
mining operations at Serra Azul
13.5% of production at Pau de Vinho
Handling fee: USD 12.63/ton adjusted
by US-PPI
Volumes:
■2013 = 4 Mtpy
■ 2014 = 8 Mtpy
■ 2015 = 12 Mtpy
Pau de Vinho Joint Mining Sudeste Superport Handling
13.5% of production at Pau de Vinho
will be delivered to Usiminas
MMX will be responsible for the
licensing, CAPEX and operation for 30
years
■ 2016 = 12 Mtpy
■ Additional 3 Mtpy will be allocated from
2013 until 2016
80% Take-or-Pay
Usiminas can renew the contract for 1
to 5 years
36
BOM SUCESSO UNIT
2.3
BOM SUCESSO
High-quality iron ore with high magnetite content to supply the
seaborne market
Highlights
Production target: 10 Mtpy
64% of production already committed through long-term
contracts
Execution Update
Conceptual engineering
EIA RIMA filed in November 2010EIA RIMA filed in November 2010
SRK resources audit update: 365 million tons plus a
potential of 741 million tons
Public Hearing: June 2011
Expected Quality – Ouro Preto pilot plant test work
Fe: 67.2% P: 0.033%
SiO2: 2.5% PPC: 0.6%
AL2O3: 0.5% FeO: 8.8%
38
CHILE
3

CHILE
One of the lowest cost additions to seaborne supply
Highlights
High-quality iron ore with magnetite content to
supply the seaborne market
Production target: 10 Mtpy
50% of production already committed through long-
term contracts
460 Mt of iron ore potential already secured
Execution Update
Castilla Port fully licensed
Drilling performed 2011: approximately 43
thousand meters
Water permits
Expected Quality – Ouro Preto pilot plant test
work
Fe: 67.50% SiO2: 2.5%
Al2O3: 0.85% P: 0.015%
40
CHILE
Castilha Port
EBX has 240,000 ha property in the Atacama region
Fully Licensed Port
Deep water port – 28 meter draft: Chinamax vessels
Water availability with permits
MPX Thermal Power Plant
BERTH N° 1 – COAL
BERTH N° 2 – IRON ORE
BERTH N° 3 – COPPER
41
CORUMBÁ

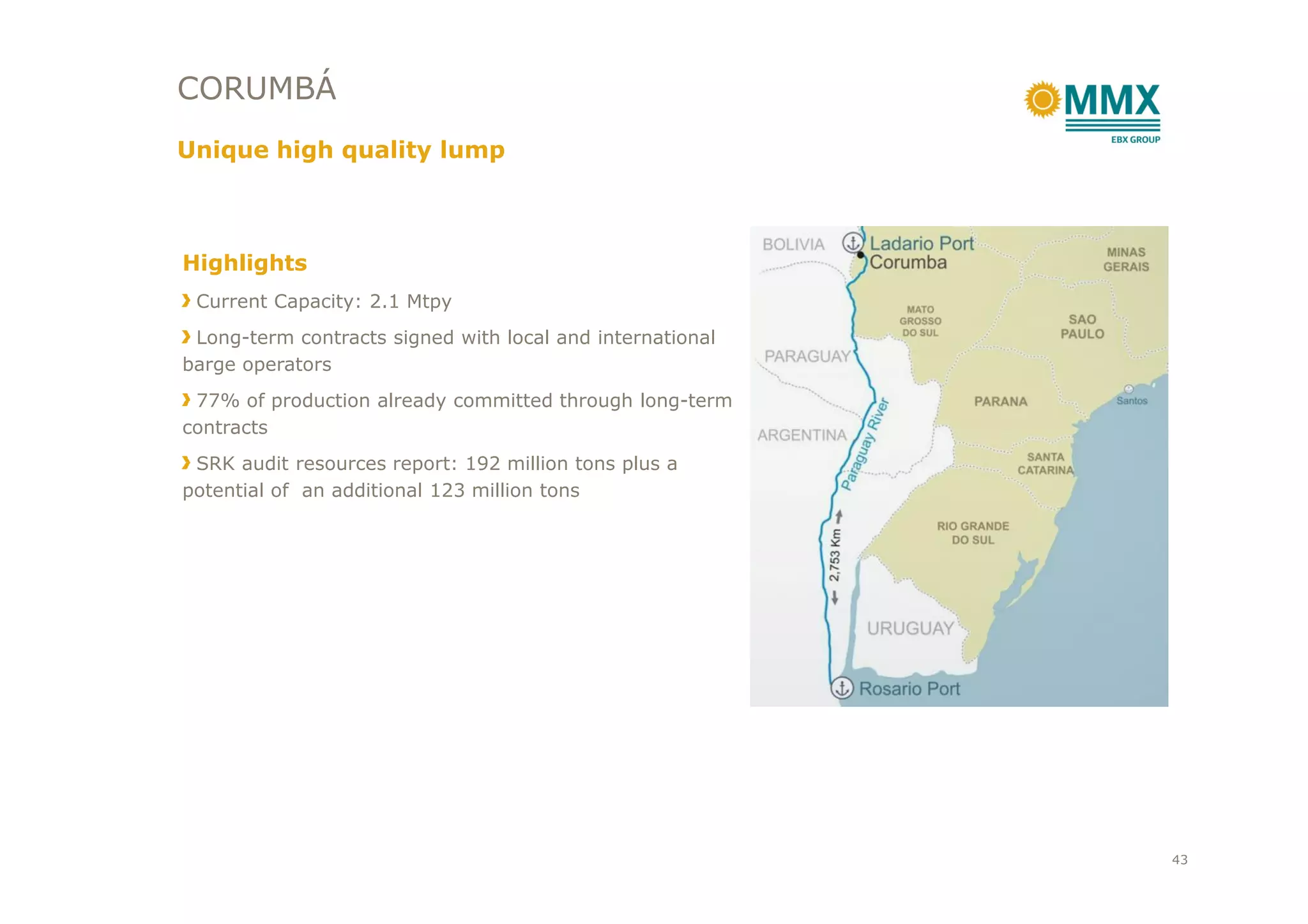

4
CORUMBÁ
Unique high quality lump
Highlights
Current Capacity: 2.1 Mtpy
Long-term contracts signed with local and international
barge operators
77% of production already committed through long-term
contracts
SRK audit resources report: 192 million tons plus aSRK audit resources report: 192 million tons plus a
potential of an additional 123 million tons
43
Investor Relations
Guilherme Escalhão – CEO and IRO
Camila Anker– Manager
Rafaela Gunzburger – Analyst
Beatriz Yoshinaga - Analyst
Tel. + 55 21 2555-6197/ 6338
ri@mmx.com.br

Corporate Presentation - February 2012

  • 1.
    MMX: CREATING CHOICESIN SEABORNE IRON ORE SUPPLY Rio de Janeiro | February 2012
  • 2.
    This presentation relatingto MMX Mineração e Metálicos S.A. (“MMX”) includes “forward-looking statements”, as that term is defined in the Private Securities Litigation Reform Act of 1995, in Section 27A of the Securities Act of 1933 and Section 21E of the U.S. Securities Exchange Act of 1934. All statements other than statements of historical facts are statements that could be deemed forward-looking statements and are often characterized by the use of words such as “projects”, “expects”, “anticipates”, “intends”, “plans”, “believes”, “estimates”, “may”, “will”, or “intends”, or by discussions or comments about our objectives, strategy, plans or intentions and results of operations. Forward-looking statements include projections regarding our operating capacity, operating expenditures, capital expenditures and start-up dates. By their nature, these forward-looking statements involve numerous assumptions, uncertainties and opportunities, both general and specific. The risk exists that these statements may not be fulfilled or, even if they are fulfilled, the results or developments described in such statements may not be indicative of results or developments in future periods. We caution participants of this presentation not to place undue reliance on these forward-looking statements as a number of factors DISCLAIMER could cause future results to differ materially from these statements. Forward-looking statements may be influenced in particular by factors such as the ability to obtain all required regulatory approvals on a timely basis or at all, exploration for mineral resources and reserves, difficulty in converting geological resources into mineral reserves, and changes in economic, political and regulatory conditions. We caution that the foregoing list is not exhaustive. When relying on forward-looking statements to make decisions, investors should carefully consider these factors as well as other uncertainties and events. MMX does not undertake to update our forward-looking statements unless required by law. This presentation is neither an offer to sell (which can only be made pursuant to definitive offering documents) nor a solicitation of an offer to buy any securities in the United States, or any other jurisdiction. The securities referred to herein have not been registered in any jurisdiction, and in particular, will not be registered under the U.S. Securities Act of 1933, as amended, or any applicable state securities laws and may not be offered or sold in the United States absent registration or an applicable exemption from such registration requirements. This presentation and its contents are proprietary information and may not be reproduced or otherwise disseminated in whole or in part without MMX’s prior written consent.
  • 3.
  • 4.
    THE ONLY ONEOF ITS KIND MMX Uniqueness Production committed to important global consumers – China and South Korea – through long- term contracts Brownfield start up Expanding beyond 50 Mtpy in Brazil and Chile, through fully integrated systems: own deep water superports and pipelines Sudeste System Serra Azul Unit Bom Sucesso UnitCorumbá System Sudeste Superport Chile System Unique port location and strong balance sheet leverage significant value creation through consolidation of stranded iron ore resources in the Southeast of Brazil Strong cash generation Proven track record delivering value to shareholders 4
  • 5.
    ESTRUTURA SOCIETÁRIA 42% Controlling Shareholders 42%Controlling Shareholders 16% Wisco16% Wisco 14% SK Networks14% SK Networks 28% Free Float28% Free Float MMXM3: SOLID CONTROLLING SHAREHOLDERS MMX Corumbá Mineração MMX Corumbá Mineração MMX SudesteMMX Sudeste Minera MMX do Chile Minera MMX do Chile Superporto Sudeste Superporto Sudeste Serra Azul Serra Azul Bom Sucesso Bom Sucesso 100% 100% 99%70% 30% EBX 5
  • 6.
    SRK certification: 3,1billion tons of mineral resources, and further mineral potential of up to 1,4 billion tons. Reserves of 1 billion tons in Serra Azul. Low strip ratio Competitive scale – New beneficiation plant Energy supply contract with MPX Integrated infrastructure with the existing MRS railway Resource Base Competitive Production Cost Structure INGREDIENTS FOR A SUCCESSFUL IRON ORE BUSINESS 64% of future production already committed through long-term contracts Experience management team with implementation and operational expertise Installed Capacity of 10 Mtpy (Serra Azul and Corumbá sites) Sudeste Superport at 50 Mtpy, expandable to 100 Mtpy, provides gateway to seaborne markets Long Term Railway Contract with MRS Integrated infrastructure with the existing MRS railway Secured Off-take Operational Track Record Guaranteed Logistics 6
  • 7.
    MMX signs contractfor railway services with MRS through 2026 SRK certified 997,4 million tons of mineral reserves at Serra Azul Unit EIA-RIMA filed for Sudeste Superport expansion to 100 Mtpa Orders for long lead equipment for Serra Azul expansion EPCM contract with CNEC Worley Parsons for Serra Azul expansion January 2012 DURING THE YEAR OF 2011, A LOT HAS BEEN DELIVERED EPCM contract with CNEC Worley Parsons for Serra Azul expansion Contract with MPX for energy supply for expansion of Serra Azul SRK certified 2,5 billion tons of resources at Serra Azul and Pau de Vinho Preliminary license of the Serra Azul expansion MOU with Minerinvest Financial advisory contract with Itaú BBA and WestLB Acquisition of 99,1% of PortX shares at the VTO auction Deal with Usiminas February 2011 7
  • 8.
    FINANCIAL HIGHLIGHTS 72.8 75.2 61.6 0 30 60 90 3Q10 2Q113Q11* EBITDA (R$ million) 88.5 90.9 (243.2) -250 -150 -50 50 3Q10 2Q11 3Q11 Net Profit (R$ million) *excluding non recurent itens 46% 37% 27% 54% 63% 73% 0% 50% 100% 3Q10 2Q11 3Q11 Debt profile Short Term Long Term 1,1 1,3 1,5 0,6 0,8 0,7 0,0 1,0 2,0 3Q10 2Q11 3Q11 Sales (million ton) Domestic Market Seaborne Market 8
  • 9.
  • 10.
    UNIQUE INTEGRATED LOGISTICS SinceIron ore is a bulk commodity, an integrated logistic (mine railway port) is the key factor for a successful operation Mine SuperportRailway Serra Azul unit is near to the MRS railway - 10 km from the mine, a distance currently traversed by trucks. MMX has a long term contract with MRS railway, which connects the mine with the CSN’s Itaguaí port and to the Sudeste Superport. Sudeste Superport is located in Itaguaí and will have 50Mtpy iron ore shipping capacity. The Superport will have a depth of 20 meters, enough to handle Capesize vessels. Offtakers (Shareholders) Long-Term contract (20 years) to trade iron ore. SK will take-off part of the Sudeste System yearly production equivalent to its participation in MMX Capital (14%). SK and Wisco will together offtake 64% of total production Long-Term contract (20 years). Wisco will off-take at least 50% of MMX Sudeste production. 10
  • 11.
  • 12.
  • 13.
    RAILWAY Railway access conectingMRS to the Sudeste Superport 13
  • 14.
    SERRA AZUL Expansion projectwith integrated logistic and pellet feed iron ore Highlights Production target: 24 Mtpy 64% of production already committed through long-term contracts 997.4 million tons of reserves already secured by SRK Execution Update Preliminary license issued in August, 2011 Acquisiion of gyratory crushers, ball mills, SAG mills and vertical mills for the new beneficiation plant for R$ 475 million Contract with CNEC WorleyParsons amounting R$ 255 million Contract with MPX to supply power for 15 years at a base-price of R$125/MWh Expected Quality – Ouro Preto pilot plant test work Fe: 67.0% P: 0.03% SiO2: 3.5% Mn: 0.5% AL2O3: 0.5% LOI: 0.25% 14
  • 15.
    SERRA AZUL Growth throughconsolidation while leveraging existing infrastructure 15
  • 16.
    SERRA AZUL Serra AzulUnit Expansion Project New Beneficiation Plant, transmission line and water pipelines, Stockyard and Loading Terminal Pit 16
  • 17.
  • 18.
    Contract signed onDecember 28th 2011. Long term contract through 2026. Provides for a volume of up to 36 million tons of iron ore per year. Tariff: R$ 26.463/ton , net of tax, readjusted annually by a parametric formula the variation in IGP-DI and in diesel oil. MRS CONTRACT MMX signed a long term contract for railway services formula the variation in IGP-DI and in diesel oil. 18
  • 19.
  • 20.
  • 21.
    Nautical Access Offshore Tunnel Stockyard 32 Stockyard06 Railway Access Sudeste Superport Artistic View 21
  • 22.
    SUDESTE SUPERPORT Overview Highlights 50 mtpycapacity, expandable to 100 mtpy Capesizes handling Loading: 2 ship loaders of 25 Mtpy each Fully funded (BNDES) Start-up forecast: 1Q13 Sudeste Superport - Itaguaí Start-up forecast: 1Q13 100% of equipment already ordered Licensing for 100 Mtpy underway 22
  • 23.
    SUDESTE SUPERPORT Overview Highlights Tunnel: Meetingof the two excavation fronts as of September 2011 EIA-RIMA for 100 Mtpy filed with Inea in September 2011 Licensed to 50 Mtpy Sudeste Superport - Itaguaí Navy Approval to 100 Mtpy 23
  • 24.
  • 25.
  • 26.
  • 27.
  • 28.
  • 29.
    11 m 20.5 m SudesteSuperport Tunnel entrance 29
  • 30.
  • 31.
  • 32.
    Pier 766 m Superporto Sudeste OffshoreStructure Bridge and Pier Bridge 250 m 32
  • 33.
  • 34.
    Funding: BNDES FINAME- PSI Total Amount: R$ 407.1 mm Interest Rate per Year: 4.50% Amortization: 8 years Grace Period: 2 years1.276 CAPEX Actual Forecast SUDESTE SUPERPORT CAPEX and Funding Funding: BNDES FINEM Total Amount: R$ 805.1 mm Interest Rate per Year: TJLP + 2.18% Amortization: 10 years Grace Period: 2 years Requested Supplementary Funding : R$ 552 million 86 40 63 286 649 2007 2008 2009 2010 2011 to 2013 34
  • 35.
    SUDESTE SUPERPORT Construction schedule PreliminaryLicense Construction LIcense Funding BNDES FINAME- PSI ANTAQ License Funding BNDES FINEM Civil Construction: 1S09 2S09 1S10 2S10 1S11 2S11 1S12 2S12 1Q13 Civil Construction: Stockyard 06 Stockyard 32 Tunnel Offshore Road-rail access Equipment sett up: Car dumpers Shiploader Stacker reclaimer Belt conveyor 35
  • 36.
    USIMINAS AGREEMENT SRK resourcesaudit : 810 million tons plus a potential 75 million tons Pau de Vinho target production: 8 Mtpy Significant synergies with current mining operations at Serra Azul 13.5% of production at Pau de Vinho Handling fee: USD 12.63/ton adjusted by US-PPI Volumes: ■2013 = 4 Mtpy ■ 2014 = 8 Mtpy ■ 2015 = 12 Mtpy Pau de Vinho Joint Mining Sudeste Superport Handling 13.5% of production at Pau de Vinho will be delivered to Usiminas MMX will be responsible for the licensing, CAPEX and operation for 30 years ■ 2016 = 12 Mtpy ■ Additional 3 Mtpy will be allocated from 2013 until 2016 80% Take-or-Pay Usiminas can renew the contract for 1 to 5 years 36
  • 37.
  • 38.
    BOM SUCESSO High-quality ironore with high magnetite content to supply the seaborne market Highlights Production target: 10 Mtpy 64% of production already committed through long-term contracts Execution Update Conceptual engineering EIA RIMA filed in November 2010EIA RIMA filed in November 2010 SRK resources audit update: 365 million tons plus a potential of 741 million tons Public Hearing: June 2011 Expected Quality – Ouro Preto pilot plant test work Fe: 67.2% P: 0.033% SiO2: 2.5% PPC: 0.6% AL2O3: 0.5% FeO: 8.8% 38
  • 39.
  • 40.
    CHILE One of thelowest cost additions to seaborne supply Highlights High-quality iron ore with magnetite content to supply the seaborne market Production target: 10 Mtpy 50% of production already committed through long- term contracts 460 Mt of iron ore potential already secured Execution Update Castilla Port fully licensed Drilling performed 2011: approximately 43 thousand meters Water permits Expected Quality – Ouro Preto pilot plant test work Fe: 67.50% SiO2: 2.5% Al2O3: 0.85% P: 0.015% 40
  • 41.
    CHILE Castilha Port EBX has240,000 ha property in the Atacama region Fully Licensed Port Deep water port – 28 meter draft: Chinamax vessels Water availability with permits MPX Thermal Power Plant BERTH N° 1 – COAL BERTH N° 2 – IRON ORE BERTH N° 3 – COPPER 41
  • 42.
  • 43.
    CORUMBÁ Unique high qualitylump Highlights Current Capacity: 2.1 Mtpy Long-term contracts signed with local and international barge operators 77% of production already committed through long-term contracts SRK audit resources report: 192 million tons plus aSRK audit resources report: 192 million tons plus a potential of an additional 123 million tons 43
  • 44.
    Investor Relations Guilherme Escalhão– CEO and IRO Camila Anker– Manager Rafaela Gunzburger – Analyst Beatriz Yoshinaga - Analyst Tel. + 55 21 2555-6197/ 6338 ri@mmx.com.br
