Chapter 4
Construction Planning
and Scheduling

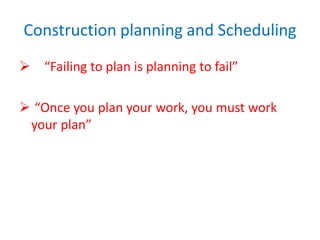

Construction planning and Scheduling
 “Failing to plan is planning to fail”
 “Once you plan your work, you must work
your plan”
 Planning
Objectives
Resources
Work break-down
structure
Organizational
break-down
structure
 Scheduling
Project activities
Start & end times
Network
 Controlling
Monitor, compare, revise, action
Introduction
12/3/2025
3

Project Management Activities
Introduction
Figure 3.1
Before Start of project During
project Timeline project
Budgets
Delayed activities report
Slack activities report
Time/cost estimates
Budgets
Engineering diagrams
Cash flow charts
Materialavailability
details
CPM/PERT
Gantt charts
Milestone charts
Cash flow schedules
12/3/2025
4

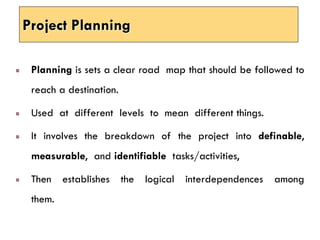

Project Planning
Planning is sets a clear road map that should be followed to
reach a destination.
Used at different levels to mean different things.
It involves the breakdown of the project into definable,
measurable, and identifiable tasks/activities,
Then establishes the logical interdependences among
them.
Project Planning
Plans involve four main steps:
 Performing breakdown of work items involved in the project into
activities.
 Identifying the proper sequence by which the activities should
be executed.
 Activities representation.
 Estimating the resources, time, and cost of individual activities
12/3/2025
8
Project Planning

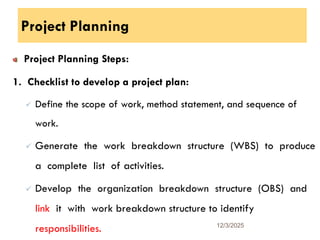

Project Planning Steps:
1. Checklist to develop a project plan:
 Define the scope of work, method statement, and sequence of
work.
 Generate the work breakdown structure (WBS) to produce
a complete list of activities.
 Develop the organization breakdown structure (OBS) and
link it with work breakdown structure to identify
responsibilities. 12/3/2025
10
Project Planning
Planning steps cont’d
 Determine the relationship between activities.
 Estimate activities time duration, cost expenditure, and
resource requirement.
 Develop the project network.
12/3/2025
11
Project Planning
Planning Steps:
2. Work Breakdown Structures [WBS]
 WBS is a hierarchical structure which is designed to
logically sub-divide all the work-elements of the project into
a graphical presentation.
 The full scope of work for the project is placed at the
top of the diagram, and then sub-divided smaller
elements of work at each lower level of the breakdown.
12/3/2025
12
Project Planning

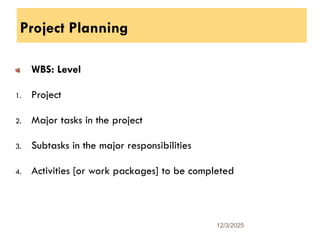

WBS: Level
1. Project
2. Major tasks in the project
3. Subtasks in the major responsibilities
4. Activities [or work packages] to be completed
12/3/2025
14
Project Planning

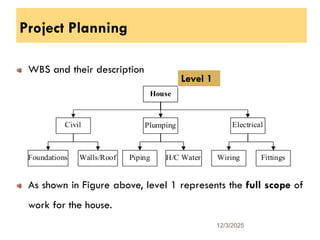

WBS and their description
As shown in Figure above, level 1 represents the full scope of
work for the house.
12/3/2025
15
Level 1

Project Planning
Accordingly, a complete WBS for the warehouse project
can be shown as follow:
12/3/2025
18

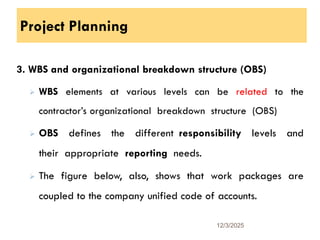

Project Planning
3. WBS and organizational breakdown structure (OBS)
 WBS elements at various levels can be related to the
contractor’s organizational breakdown structure (OBS)
 OBS defines the different responsibility levels and
their appropriate reporting needs.
 The figure below, also, shows that work packages are
coupled to the company unified code of accounts.
12/3/2025
19
Project Planning
A sample Project organization
12/3/2025
20
Marketing Finance
Human
Resources Design
Quality
Mgt
Production
President
Test
Engineer
Mechanical
Engineer
Project 1 Project
Manager
Technician
Technician
Project 2 Project
Manager
Electrical
Engineer
Computer
Engineer
Project Planning
Project Organization
12/3/2025
21
Marketing Operations Engineering Finance
Project 1
Project 2
Project 3
Project 4
Project Planning
Planning Steps:
4. Project Activities
 An activity is defined as any function or decision in the
project that: consumes time, resources, and cost.
 Activities are classified to three types:
12/3/2025
22
Project Planning
a. Production activities: activities that involve the use of
resources such as labor, equipment, material, or
subcontractor.
This type of activities can be easily identified by reading
the project’s drawings and specifications.
Examples: excavation, formwork, reinforcement, concreting etc
Each production activity can have a certain quantity of work,
resource needs, costs, and duration. 12/3/2025
23
Project Planning

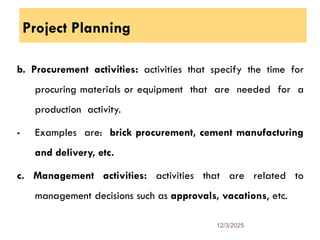

b. Procurement activities: activities that specify the time for
procuring materials or equipment that are needed for a
production activity.
 Examples are: brick procurement, cement manufacturing
and delivery, etc.
c. Management activities: activities that are related to
management decisions such as approvals, vacations, etc.
12/3/2025
24
Types of activities relationships
Four types of relationships among activities
Typically, relationships are defined from the predecessor to
the successor activity.
a) Finish to start (FS): The successor activity can begin only
when the current activity completes.
b) Finish to finish (FF): The finish of the successor activity
depends on the finish of the current activity.
12/3/2025
26

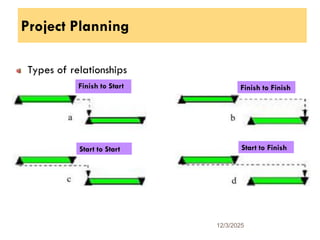

Project Planning
Cont’d
c) Start to start (SS). The start of the successor activity depends
on the start of the current activity.
d) Start to finish (SF). The successor activity cannot finish until the
current activity starts.
12/3/2025
27
Project Planning
Types of relationships
12/3/2025
28
Start to Finish
Start to Start
Finish to Finish
Finish to Start
Project Scheduling
How long the total project duration is?
Evaluate the early and late times at which activities start
and finish.
Identify the group of critical activities so that special care is
taken to make sure they are not delayed.
All these statements are the basic objectives of the scheduling
process,
Scheduling = Planning + Time. 12/3/2025
29
Project Scheduling

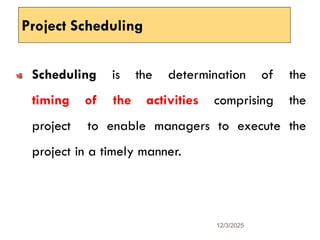

Scheduling is the determination of the
timing of the activities comprising the
project to enable managers to execute the
project in a timely manner.
12/3/2025
30
Project scheduling

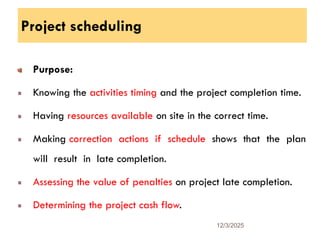

Purpose:
Knowing the activities timing and the project completion time.
Having resources available on site in the correct time.
Making correction actions if schedule shows that the plan
will result in late completion.
Assessing the value of penalties on project late completion.
Determining the project cash flow.
12/3/2025
31
Planning/Scheduling Tools
2.1 Bar Chart

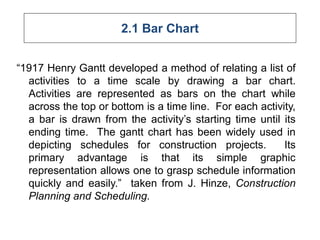

“1917 Henry Gantt developed a method of relating a list of
activities to a time scale by drawing a bar chart.
Activities are represented as bars on the chart while
across the top or bottom is a time line. For each activity,
a bar is drawn from the activity’s starting time until its
ending time. The gantt chart has been widely used in
depicting schedules for construction projects. Its
primary advantage is that its simple graphic
representation allows one to grasp schedule information
quickly and easily.” taken from J. Hinze, Construction
Planning and Scheduling.
Cont…..

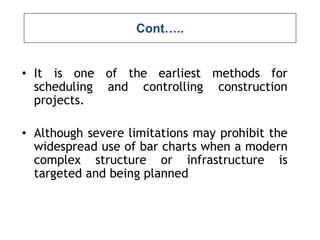

• It is one of the earliest methods for
scheduling and controlling construction
projects.
• Although severe limitations may prohibit the
widespread use of bar charts when a modern
complex structure or infrastructure is
targeted and being planned
2.1 Bar Chart
• A bar chart shows the total project in a compact
format and provides the opportunity for visualizing the
plan and the progress of the project.
• Format and provides the opportunity for visualizing
the plan and the progress of the project.

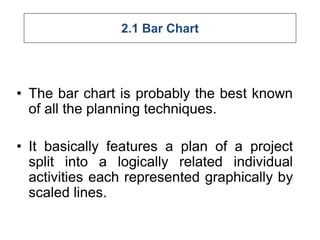

2.1 Bar Chart
• The bar chart is probably the best known
of all the planning techniques.
• It basically features a plan of a project
split into a logically related individual
activities each represented graphically by
scaled lines.
2.1 Bar Chart

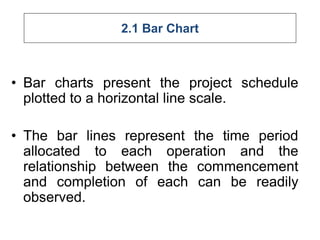

• Bar charts present the project schedule
plotted to a horizontal line scale.
• The bar lines represent the time period
allocated to each operation and the
relationship between the commencement
and completion of each can be readily
observed.
2.1 Bar Chart
• The bar chart has been the traditional
management device for planning and
scheduling construction projects.
• Bar charts are particularly helpful for
communicating the current state and
schedule of activities on a project.

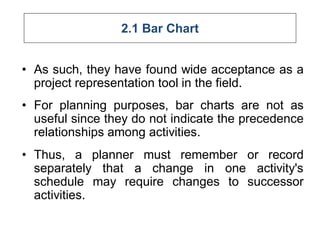

2.1 Bar Chart
• As such, they have found wide acceptance as a
project representation tool in the field.
• For planning purposes, bar charts are not as
useful since they do not indicate the precedence
relationships among activities.
• Thus, a planner must remember or record
separately that a change in one activity's
schedule may require changes to successor
activities.

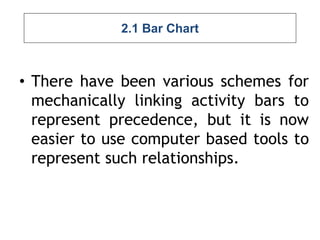

2.1 Bar Chart
• There have been various schemes for
mechanically linking activity bars to
represent precedence, but it is now
easier to use computer based tools to
represent such relationships.
2.1 Bar Chart
2.1 Bar Chart
• Advantages of Bar chart:
 Useful to report information to people who are
concerned about a project but may not be involved
in day-today management.
 A simple format and readily understood at all
levels of management,
 It can provide a quick, visual overview of a project
in convenient way to monitor job progresses,
schedule equipment and crews and record project
advancement.
2.1 Bar Chart

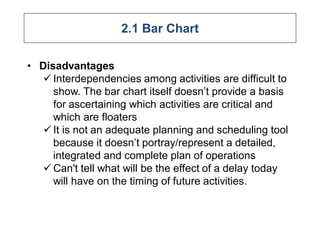

• Disadvantages
 Interdependencies among activities are difficult to
show. The bar chart itself doesn’t provide a basis
for ascertaining which activities are critical and
which are floaters
 It is not an adequate planning and scheduling tool
because it doesn’t portray/represent a detailed,
integrated and complete plan of operations
 Can't tell what will be the effect of a delay today
will have on the timing of future activities.
2.1 Bar Chart
Summary.. . Bar Chart
• Is a simple, visual scheduling tool that is easy to use
• is a diagram divided into columns and rows
• Columns represent a given time-scale expressed as
months, weeks, days or even hours
• Horizontal rows represent activities which are
scheduled as bars
Cont’d…

Activities (2017) Apartment X’s Six Month Schedule
April May June July Aug Sep
Site clearing
Bulk Excavation
Trench Excavation
Placing formwork for Footing
Placing reinforcement for concrete
Pouring Footing Concrete
Cont’d…

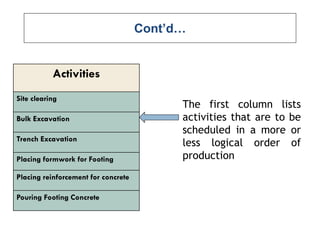

Activities
Site clearing
Bulk Excavation
Trench Excavation
Placing formwork for Footing
Placing reinforcement for concrete
Pouring Footing Concrete
The first column lists
activities that are to be
scheduled in a more or
less logical order of
production
Cont’d…
Activities (2017) Apartment X’s Six Month Schedule
April May June July Aug Sep
Site clearing
The production process is represented by
horizontal bars which are drawn for each
activity within the time-frame of the bar chart
Example

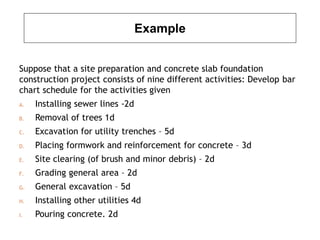

Suppose that a site preparation and concrete slab foundation
construction project consists of nine different activities: Develop bar
chart schedule for the activities given
A. Installing sewer lines -2d
B. Removal of trees 1d
C. Excavation for utility trenches – 5d
D. Placing formwork and reinforcement for concrete – 3d
E. Site clearing (of brush and minor debris) – 2d
F. Grading general area – 2d
G. General excavation – 5d
H. Installing other utilities 4d
I. Pouring concrete. 2d

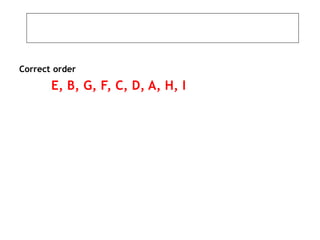

Correct order
E, B, G, F, C, D, A, H, I
Project Scheduling
Schedule using Gant chart
12/3/2025
52
Activity Description Time (weeks)
A Build internal components 2
B Modify roof and floor 3
C Construct collection stack 2
D Pour concrete and install frame 4
E Build high-temperature burner 4
F Install pollution control system 3
G Install air pollution device 5
H Inspect and test 2
Total Time (weeks) 25
Immediate
Predecessors
—
—
A
A, B
C
C
D, E
F, G

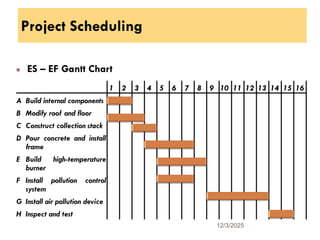

Project Scheduling
ES – EF Gantt Chart
12/3/2025
53
A Build internal components
B Modify roof and floor
C Construct collection stack
D Pour concrete and install
frame
E Build high-temperature
burner
F Install pollution control
system
G Install air pollution device
H Inspect and test
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16
2.2 What is network scheduling?
• a network schedule is a logical and ordered
sequence of events that describes in graphical
form the approach that will be taken to
complete the project.
• is a method of scheduling activities by joining
them in a series of interconnected links,
which reflect relationships of activities by the
planner
Cont’d…
• A network consists of two basic
elements, nodes, and links between the
nodes.
• Networks are used as scheduling tools
for effective construction management.
• A network schedule provides many
opportunities for construction managers.

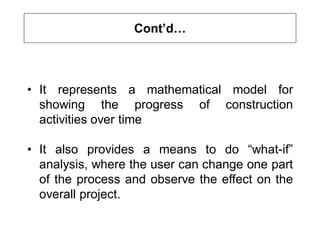

Cont’d…
• It represents a mathematical model for
showing the progress of construction
activities over time
• It also provides a means to do “what-if”
analysis, where the user can change one part
of the process and observe the effect on the
overall project.

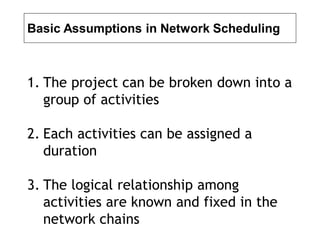

Basic Assumptions in Network Scheduling
1. The project can be broken down into a
group of activities
2. Each activities can be assigned a
duration
3. The logical relationship among
activities are known and fixed in the
network chains

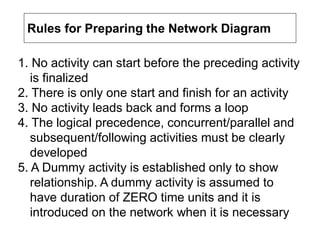

Rules for Preparing the Network Diagram
1. No activity can start before the preceding activity
is finalized
2. There is only one start and finish for an activity
3. No activity leads back and forms a loop
4. The logical precedence, concurrent/parallel and
subsequent/following activities must be clearly
developed
5. A Dummy activity is established only to show
relationship. A dummy activity is assumed to
have duration of ZERO time units and it is
introduced on the network when it is necessary
Presentation of Networks
• Showing the job activities and their order of
sequence (logic) in pictorial form produces
the project network.
• This network is a graphical display of the
proposed plan.
• There are two methods. These are: -
Why network schedules are used?
B D
A F
C E
1 2
6
5
4
3
Arrow or Activity on Arrow Diagram (AoA)

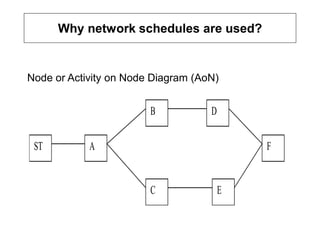

Why network schedules are used?
Node or Activity on Node Diagram (AoN)
ST F
E
D
C
B
A

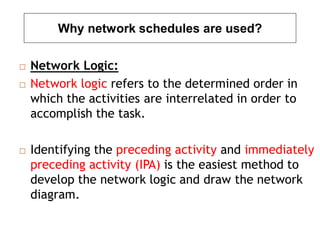

Why network schedules are used?
 Network Logic:
 Network logic refers to the determined order in
which the activities are interrelated in order to
accomplish the task.
 Identifying the preceding activity and immediately
preceding activity (IPA) is the easiest method to
develop the network logic and draw the network
diagram.

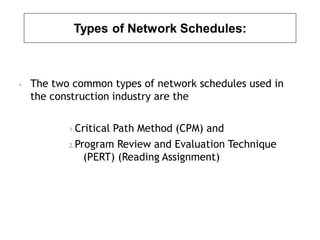

Types of Network Schedules:
• The two common types of network schedules used in
the construction industry are the
1.Critical Path Method (CPM) and
2.Program Review and Evaluation Technique
(PERT) (Reading Assignment)
1. Critical Path Method (CPM)
• Is the most widely used scheduling technique
• It calculates the minimum completion time
for a project along with the possible start and
finish times for the project activities
Critical Path Method (CPM)
• Computer programs for critical path scheduling can
efficiently handle projects with thousands of activities
• The critical path itself represents the set or sequence
of predecessor/successor activities which will take the
longest time to complete.
• The duration of the critical path is the sum of the
activities' durations along the path
Critical Path Method (CPM)
• Thus, the critical path can be defined as the longest
possible path through the "network" of project
activities.
• The duration of the critical path represents the
minimum time required to complete a project.
• Any delays along the critical path would imply that
additional time would be required to complete the
project
Critical Path Method (CPM)
• Formally, critical path scheduling assumes that
a project has been divided into activities of
fixed duration and well defined predecessor
relationships
• A predecessor relationship implies that one
activity must come before another in the
schedule
• No resource constraints other than those
implied by precedence relationships are
recognized in the simplest form of critical path
scheduling (consider there is no resource constraints)
Critical Path Method (CPM) {see examples}

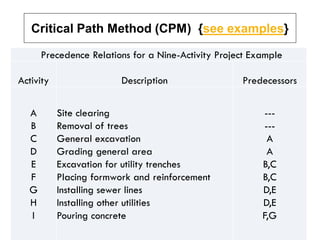

Precedence Relations for a Nine-Activity Project Example
Activity Description Predecessors
A
B
C
D
E
F
G
H
I
Site clearing
Removal of trees
General excavation
Grading general area
Excavation for utility trenches
Placing formwork and reinforcement
Installing sewer lines
Installing other utilities
Pouring concrete
---
---
A
A
B,C
B,C
D,E
D,E
F,G
Activity Predecessors
A None
B A

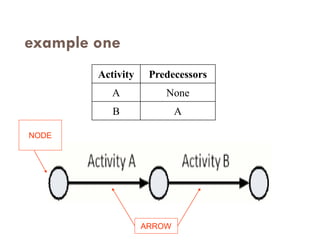

example one
NODE
ARROW

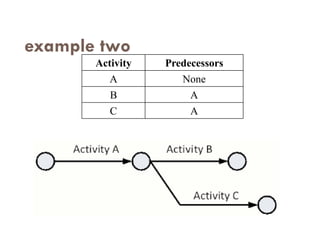

example two
Activity Predecessors
A None
B A
C A
example three
Activity Predecessors
A None
B None
C A, B
D A, B

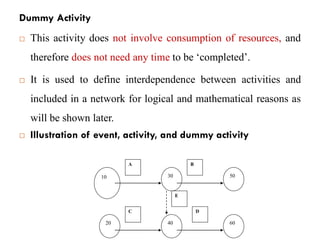

Dummy Activity
 This activity does not involve consumption of resources, and
therefore does not need any time to be ‘completed’.
 It is used to define interdependence between activities and
included in a network for logical and mathematical reasons as
will be shown later.
 Illustration of event, activity, and dummy activity
72
10 30 50
20 40 60
A B
C D
E

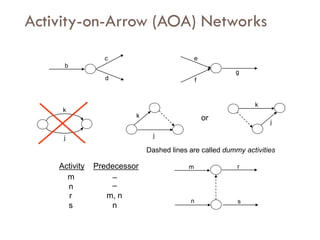

Activity-on-Arrow (AOA) Networks
b
c
d
e
f
g
Activity Predecessor
m
n
r
s
_
_
m, n
n
m r
n s
k
j
k
j
j
k
or
Dashed lines are called dummy activities
examples for you to try
Activity
Predecessors
Activity
A None
B A
C A
D B, C
Activity
Predecessors
Activity
A None
B None
C A
D A, B
Project Network Example 4
Actv. Pred. Actv. Pred.
a -- g c,d
b -- h e
c a i f
d a j e,g
e b k h,i
f b
Draw AOA networks
Activity-on-Arrow (AOA or ADM) Network
(Final Network)
a
b
d
c
g
j
k
i
h
f
e

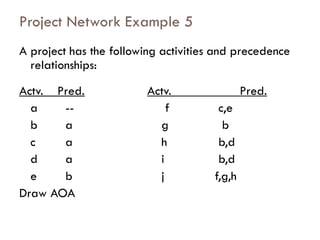

A project has the following activities and precedence
relationships:
Actv. Pred. Actv. Pred.
a -- f c,e
b a g b
c a h b,d
d a i b,d
e b j f,g,h
Draw AOA

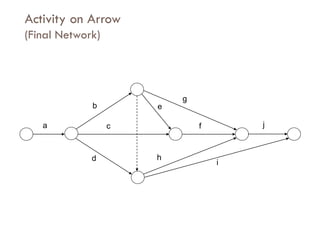

Project Network Example 5
Activity on Arrow
(Final Network)
a
b
c
d
e
f
g
h
i
j
Example-6
For the project indicated below, Develop a clear logic network for the activities.
a. AOA
b. AON
Project Scheduling [CPM]
AOA Example
12/3/2025
80

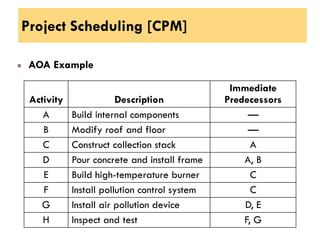

Activity Description
Immediate
Predecessors
A Build internal components —
B Modify roof and floor —
C Construct collection stack A
D Pour concrete and install frame A, B
E Build high-temperature burner C
F Install pollution control system C
G Install air pollution device D, E
H Inspect and test F, G
Project Scheduling [CPM]

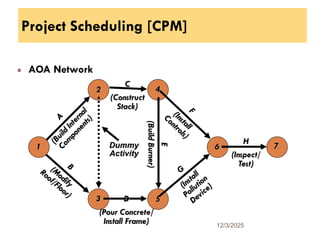

AOA Network
12/3/2025
81
1
3
2
5
D
(Pour Concrete/
Install Frame)
4
C
(Construct
Stack)
Dummy
Activity
6
H
(Inspect/
Test)
7
Project Scheduling [CPM]
AON Network
12/3/2025
82
A
Start
B
Activity A
(Build Internal Components)
Activity B
(Modify Roof and Floor)

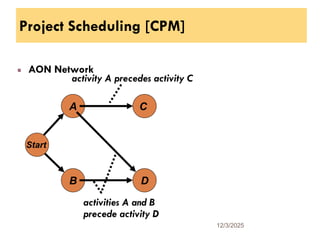

Project Scheduling [CPM]
AON Network
12/3/2025
83
A
Start
B
C
D
activity A precedes activity C
activities A and B
precede activity D
Project Scheduling [CPM]

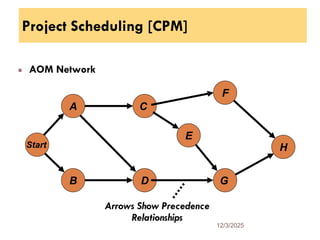

AOM Network
12/3/2025
84
C
A
Start
D
B G
E
F
H
Arrows Show Precedence
Relationships

Chapter 4 Planning and Scheduling 1_84.pdf

  • 1.
  • 2.
    Construction planning andScheduling  “Failing to plan is planning to fail”  “Once you plan your work, you must work your plan”
  • 3.
     Planning Objectives Resources Work break-down structure Organizational break-down structure Scheduling Project activities Start & end times Network  Controlling Monitor, compare, revise, action Introduction 12/3/2025 3 Project Management Activities
  • 4.
    Introduction Figure 3.1 Before Startof project During project Timeline project Budgets Delayed activities report Slack activities report Time/cost estimates Budgets Engineering diagrams Cash flow charts Materialavailability details CPM/PERT Gantt charts Milestone charts Cash flow schedules 12/3/2025 4
  • 5.
    Project Planning Planning issets a clear road map that should be followed to reach a destination. Used at different levels to mean different things. It involves the breakdown of the project into definable, measurable, and identifiable tasks/activities, Then establishes the logical interdependences among them.
  • 6.
    Project Planning Plans involvefour main steps:  Performing breakdown of work items involved in the project into activities.  Identifying the proper sequence by which the activities should be executed.  Activities representation.  Estimating the resources, time, and cost of individual activities 12/3/2025 8
  • 7.
    Project Planning Project PlanningSteps: 1. Checklist to develop a project plan:  Define the scope of work, method statement, and sequence of work.  Generate the work breakdown structure (WBS) to produce a complete list of activities.  Develop the organization breakdown structure (OBS) and link it with work breakdown structure to identify responsibilities. 12/3/2025 10
  • 8.
    Project Planning Planning stepscont’d  Determine the relationship between activities.  Estimate activities time duration, cost expenditure, and resource requirement.  Develop the project network. 12/3/2025 11
  • 9.
    Project Planning Planning Steps: 2.Work Breakdown Structures [WBS]  WBS is a hierarchical structure which is designed to logically sub-divide all the work-elements of the project into a graphical presentation.  The full scope of work for the project is placed at the top of the diagram, and then sub-divided smaller elements of work at each lower level of the breakdown. 12/3/2025 12
  • 10.
    Project Planning WBS: Level 1.Project 2. Major tasks in the project 3. Subtasks in the major responsibilities 4. Activities [or work packages] to be completed 12/3/2025 14
  • 11.
    Project Planning WBS andtheir description As shown in Figure above, level 1 represents the full scope of work for the house. 12/3/2025 15 Level 1
  • 12.
    Project Planning Accordingly, acomplete WBS for the warehouse project can be shown as follow: 12/3/2025 18
  • 13.
    Project Planning 3. WBSand organizational breakdown structure (OBS)  WBS elements at various levels can be related to the contractor’s organizational breakdown structure (OBS)  OBS defines the different responsibility levels and their appropriate reporting needs.  The figure below, also, shows that work packages are coupled to the company unified code of accounts. 12/3/2025 19
  • 14.
    Project Planning A sampleProject organization 12/3/2025 20 Marketing Finance Human Resources Design Quality Mgt Production President Test Engineer Mechanical Engineer Project 1 Project Manager Technician Technician Project 2 Project Manager Electrical Engineer Computer Engineer
  • 15.
    Project Planning Project Organization 12/3/2025 21 MarketingOperations Engineering Finance Project 1 Project 2 Project 3 Project 4
  • 16.
    Project Planning Planning Steps: 4.Project Activities  An activity is defined as any function or decision in the project that: consumes time, resources, and cost.  Activities are classified to three types: 12/3/2025 22
  • 17.
    Project Planning a. Productionactivities: activities that involve the use of resources such as labor, equipment, material, or subcontractor. This type of activities can be easily identified by reading the project’s drawings and specifications. Examples: excavation, formwork, reinforcement, concreting etc Each production activity can have a certain quantity of work, resource needs, costs, and duration. 12/3/2025 23
  • 18.
    Project Planning b. Procurementactivities: activities that specify the time for procuring materials or equipment that are needed for a production activity.  Examples are: brick procurement, cement manufacturing and delivery, etc. c. Management activities: activities that are related to management decisions such as approvals, vacations, etc. 12/3/2025 24
  • 19.
    Types of activitiesrelationships Four types of relationships among activities Typically, relationships are defined from the predecessor to the successor activity. a) Finish to start (FS): The successor activity can begin only when the current activity completes. b) Finish to finish (FF): The finish of the successor activity depends on the finish of the current activity. 12/3/2025 26
  • 20.
    Project Planning Cont’d c) Startto start (SS). The start of the successor activity depends on the start of the current activity. d) Start to finish (SF). The successor activity cannot finish until the current activity starts. 12/3/2025 27
  • 21.
    Project Planning Types ofrelationships 12/3/2025 28 Start to Finish Start to Start Finish to Finish Finish to Start
  • 22.
    Project Scheduling How longthe total project duration is? Evaluate the early and late times at which activities start and finish. Identify the group of critical activities so that special care is taken to make sure they are not delayed. All these statements are the basic objectives of the scheduling process, Scheduling = Planning + Time. 12/3/2025 29
  • 23.
    Project Scheduling Scheduling isthe determination of the timing of the activities comprising the project to enable managers to execute the project in a timely manner. 12/3/2025 30
  • 24.
    Project scheduling Purpose: Knowing theactivities timing and the project completion time. Having resources available on site in the correct time. Making correction actions if schedule shows that the plan will result in late completion. Assessing the value of penalties on project late completion. Determining the project cash flow. 12/3/2025 31
  • 25.
  • 26.

    2.1 Bar Chart “1917Henry Gantt developed a method of relating a list of activities to a time scale by drawing a bar chart. Activities are represented as bars on the chart while across the top or bottom is a time line. For each activity, a bar is drawn from the activity’s starting time until its ending time. The gantt chart has been widely used in depicting schedules for construction projects. Its primary advantage is that its simple graphic representation allows one to grasp schedule information quickly and easily.” taken from J. Hinze, Construction Planning and Scheduling.
  • 27.
    Cont….. • It isone of the earliest methods for scheduling and controlling construction projects. • Although severe limitations may prohibit the widespread use of bar charts when a modern complex structure or infrastructure is targeted and being planned
  • 28.
    2.1 Bar Chart •A bar chart shows the total project in a compact format and provides the opportunity for visualizing the plan and the progress of the project. • Format and provides the opportunity for visualizing the plan and the progress of the project.
  • 29.

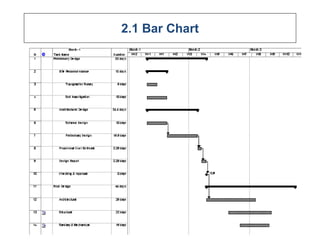

    2.1 Bar Chart •The bar chart is probably the best known of all the planning techniques. • It basically features a plan of a project split into a logically related individual activities each represented graphically by scaled lines.
  • 30.
    2.1 Bar Chart •Bar charts present the project schedule plotted to a horizontal line scale. • The bar lines represent the time period allocated to each operation and the relationship between the commencement and completion of each can be readily observed.
  • 31.
    2.1 Bar Chart •The bar chart has been the traditional management device for planning and scheduling construction projects. • Bar charts are particularly helpful for communicating the current state and schedule of activities on a project.
  • 32.
    2.1 Bar Chart •As such, they have found wide acceptance as a project representation tool in the field. • For planning purposes, bar charts are not as useful since they do not indicate the precedence relationships among activities. • Thus, a planner must remember or record separately that a change in one activity's schedule may require changes to successor activities.
  • 33.
    2.1 Bar Chart •There have been various schemes for mechanically linking activity bars to represent precedence, but it is now easier to use computer based tools to represent such relationships.
  • 34.
  • 35.
    2.1 Bar Chart •Advantages of Bar chart:  Useful to report information to people who are concerned about a project but may not be involved in day-today management.  A simple format and readily understood at all levels of management,  It can provide a quick, visual overview of a project in convenient way to monitor job progresses, schedule equipment and crews and record project advancement.
  • 36.
    2.1 Bar Chart •Disadvantages  Interdependencies among activities are difficult to show. The bar chart itself doesn’t provide a basis for ascertaining which activities are critical and which are floaters  It is not an adequate planning and scheduling tool because it doesn’t portray/represent a detailed, integrated and complete plan of operations  Can't tell what will be the effect of a delay today will have on the timing of future activities.
  • 37.
  • 38.
    Summary.. . BarChart • Is a simple, visual scheduling tool that is easy to use • is a diagram divided into columns and rows • Columns represent a given time-scale expressed as months, weeks, days or even hours • Horizontal rows represent activities which are scheduled as bars
  • 39.
    Cont’d… Activities (2017) ApartmentX’s Six Month Schedule April May June July Aug Sep Site clearing Bulk Excavation Trench Excavation Placing formwork for Footing Placing reinforcement for concrete Pouring Footing Concrete
  • 40.
    Cont’d… Activities Site clearing Bulk Excavation TrenchExcavation Placing formwork for Footing Placing reinforcement for concrete Pouring Footing Concrete The first column lists activities that are to be scheduled in a more or less logical order of production
  • 41.
    Cont’d… Activities (2017) ApartmentX’s Six Month Schedule April May June July Aug Sep Site clearing The production process is represented by horizontal bars which are drawn for each activity within the time-frame of the bar chart
  • 42.
    Example Suppose that asite preparation and concrete slab foundation construction project consists of nine different activities: Develop bar chart schedule for the activities given A. Installing sewer lines -2d B. Removal of trees 1d C. Excavation for utility trenches – 5d D. Placing formwork and reinforcement for concrete – 3d E. Site clearing (of brush and minor debris) – 2d F. Grading general area – 2d G. General excavation – 5d H. Installing other utilities 4d I. Pouring concrete. 2d
  • 43.
    Correct order E, B,G, F, C, D, A, H, I
  • 44.
    Project Scheduling Schedule usingGant chart 12/3/2025 52 Activity Description Time (weeks) A Build internal components 2 B Modify roof and floor 3 C Construct collection stack 2 D Pour concrete and install frame 4 E Build high-temperature burner 4 F Install pollution control system 3 G Install air pollution device 5 H Inspect and test 2 Total Time (weeks) 25 Immediate Predecessors — — A A, B C C D, E F, G
  • 45.
    Project Scheduling ES –EF Gantt Chart 12/3/2025 53 A Build internal components B Modify roof and floor C Construct collection stack D Pour concrete and install frame E Build high-temperature burner F Install pollution control system G Install air pollution device H Inspect and test 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16
  • 46.
    2.2 What isnetwork scheduling? • a network schedule is a logical and ordered sequence of events that describes in graphical form the approach that will be taken to complete the project. • is a method of scheduling activities by joining them in a series of interconnected links, which reflect relationships of activities by the planner
  • 47.
    Cont’d… • A networkconsists of two basic elements, nodes, and links between the nodes. • Networks are used as scheduling tools for effective construction management. • A network schedule provides many opportunities for construction managers.
  • 48.
    Cont’d… • It representsa mathematical model for showing the progress of construction activities over time • It also provides a means to do “what-if” analysis, where the user can change one part of the process and observe the effect on the overall project.
  • 49.
    Basic Assumptions inNetwork Scheduling 1. The project can be broken down into a group of activities 2. Each activities can be assigned a duration 3. The logical relationship among activities are known and fixed in the network chains
  • 50.
    Rules for Preparingthe Network Diagram 1. No activity can start before the preceding activity is finalized 2. There is only one start and finish for an activity 3. No activity leads back and forms a loop 4. The logical precedence, concurrent/parallel and subsequent/following activities must be clearly developed 5. A Dummy activity is established only to show relationship. A dummy activity is assumed to have duration of ZERO time units and it is introduced on the network when it is necessary
  • 51.
    Presentation of Networks •Showing the job activities and their order of sequence (logic) in pictorial form produces the project network. • This network is a graphical display of the proposed plan. • There are two methods. These are: -
  • 52.
    Why network schedulesare used? B D A F C E 1 2 6 5 4 3 Arrow or Activity on Arrow Diagram (AoA)
  • 53.
    Why network schedulesare used? Node or Activity on Node Diagram (AoN) ST F E D C B A
  • 54.
    Why network schedulesare used?  Network Logic:  Network logic refers to the determined order in which the activities are interrelated in order to accomplish the task.  Identifying the preceding activity and immediately preceding activity (IPA) is the easiest method to develop the network logic and draw the network diagram.
  • 55.
    Types of NetworkSchedules: • The two common types of network schedules used in the construction industry are the 1.Critical Path Method (CPM) and 2.Program Review and Evaluation Technique (PERT) (Reading Assignment)
  • 56.
    1. Critical PathMethod (CPM) • Is the most widely used scheduling technique • It calculates the minimum completion time for a project along with the possible start and finish times for the project activities
  • 57.
    Critical Path Method(CPM) • Computer programs for critical path scheduling can efficiently handle projects with thousands of activities • The critical path itself represents the set or sequence of predecessor/successor activities which will take the longest time to complete. • The duration of the critical path is the sum of the activities' durations along the path
  • 58.
    Critical Path Method(CPM) • Thus, the critical path can be defined as the longest possible path through the "network" of project activities. • The duration of the critical path represents the minimum time required to complete a project. • Any delays along the critical path would imply that additional time would be required to complete the project
  • 59.
    Critical Path Method(CPM) • Formally, critical path scheduling assumes that a project has been divided into activities of fixed duration and well defined predecessor relationships • A predecessor relationship implies that one activity must come before another in the schedule • No resource constraints other than those implied by precedence relationships are recognized in the simplest form of critical path scheduling (consider there is no resource constraints)
  • 60.
    Critical Path Method(CPM) {see examples} Precedence Relations for a Nine-Activity Project Example Activity Description Predecessors A B C D E F G H I Site clearing Removal of trees General excavation Grading general area Excavation for utility trenches Placing formwork and reinforcement Installing sewer lines Installing other utilities Pouring concrete --- --- A A B,C B,C D,E D,E F,G
  • 61.
    Activity Predecessors A None BA example one NODE ARROW
  • 62.
  • 63.
    example three Activity Predecessors ANone B None C A, B D A, B
  • 64.
    Dummy Activity  Thisactivity does not involve consumption of resources, and therefore does not need any time to be ‘completed’.  It is used to define interdependence between activities and included in a network for logical and mathematical reasons as will be shown later.  Illustration of event, activity, and dummy activity 72 10 30 50 20 40 60 A B C D E
  • 65.
    Activity-on-Arrow (AOA) Networks b c d e f g ActivityPredecessor m n r s _ _ m, n n m r n s k j k j j k or Dashed lines are called dummy activities
  • 66.
    examples for youto try Activity Predecessors Activity A None B A C A D B, C Activity Predecessors Activity A None B None C A D A, B
  • 67.
    Project Network Example4 Actv. Pred. Actv. Pred. a -- g c,d b -- h e c a i f d a j e,g e b k h,i f b Draw AOA networks
  • 68.
    Activity-on-Arrow (AOA orADM) Network (Final Network) a b d c g j k i h f e
  • 69.
    A project hasthe following activities and precedence relationships: Actv. Pred. Actv. Pred. a -- f c,e b a g b c a h b,d d a i b,d e b j f,g,h Draw AOA Project Network Example 5
  • 70.
    Activity on Arrow (FinalNetwork) a b c d e f g h i j
  • 71.
    Example-6 For the projectindicated below, Develop a clear logic network for the activities. a. AOA b. AON
  • 72.
    Project Scheduling [CPM] AOAExample 12/3/2025 80 Activity Description Immediate Predecessors A Build internal components — B Modify roof and floor — C Construct collection stack A D Pour concrete and install frame A, B E Build high-temperature burner C F Install pollution control system C G Install air pollution device D, E H Inspect and test F, G
  • 73.
    Project Scheduling [CPM] AOANetwork 12/3/2025 81 1 3 2 5 D (Pour Concrete/ Install Frame) 4 C (Construct Stack) Dummy Activity 6 H (Inspect/ Test) 7
  • 74.
    Project Scheduling [CPM] AONNetwork 12/3/2025 82 A Start B Activity A (Build Internal Components) Activity B (Modify Roof and Floor)
  • 75.
    Project Scheduling [CPM] AONNetwork 12/3/2025 83 A Start B C D activity A precedes activity C activities A and B precede activity D
  • 76.
    Project Scheduling [CPM] AOMNetwork 12/3/2025 84 C A Start D B G E F H Arrows Show Precedence Relationships
