1

            Peterborough
            Buildings in Need
            September 2011 – June 2012

Heritage Lottery Fund Project Reference: YH-11-00479
Project Update: June 2012
Report Author: Alice Kershaw, Heritage Regeneration Officer, Opportunity
Peterborough
2
3

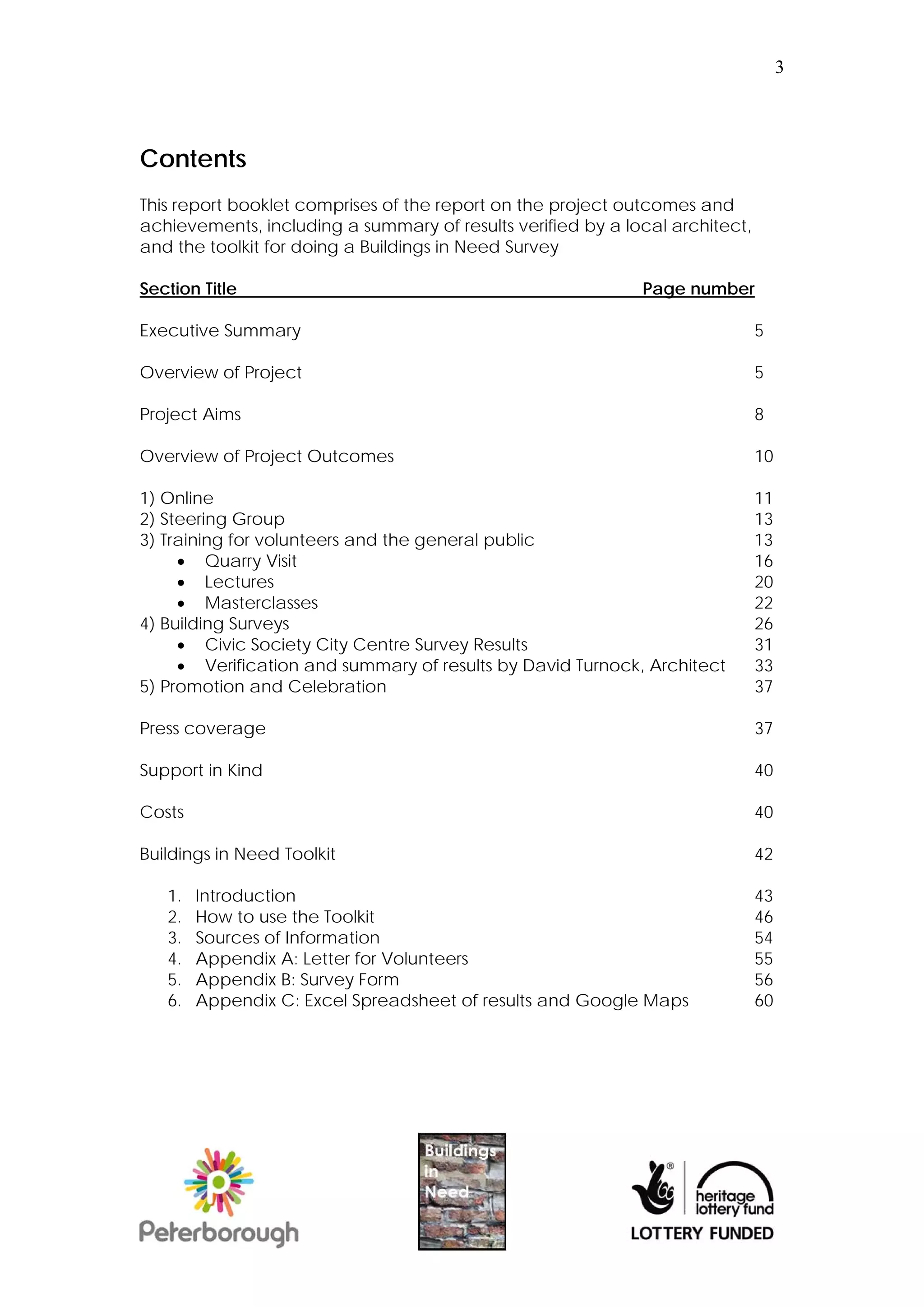

Contents
This report booklet comprises of the report on the project outcomes and
achievements, including a summary of results verified by a local architect,
and the toolkit for doing a Buildings in Need Survey

Section Title                                                Page number

Executive Summary                                                             5

Overview of Project                                                           5

Project Aims                                                                  8

Overview of Project Outcomes                                                  10

1) Online                                                                     11
2) Steering Group                                                             13
3) Training for volunteers and the general public                             13

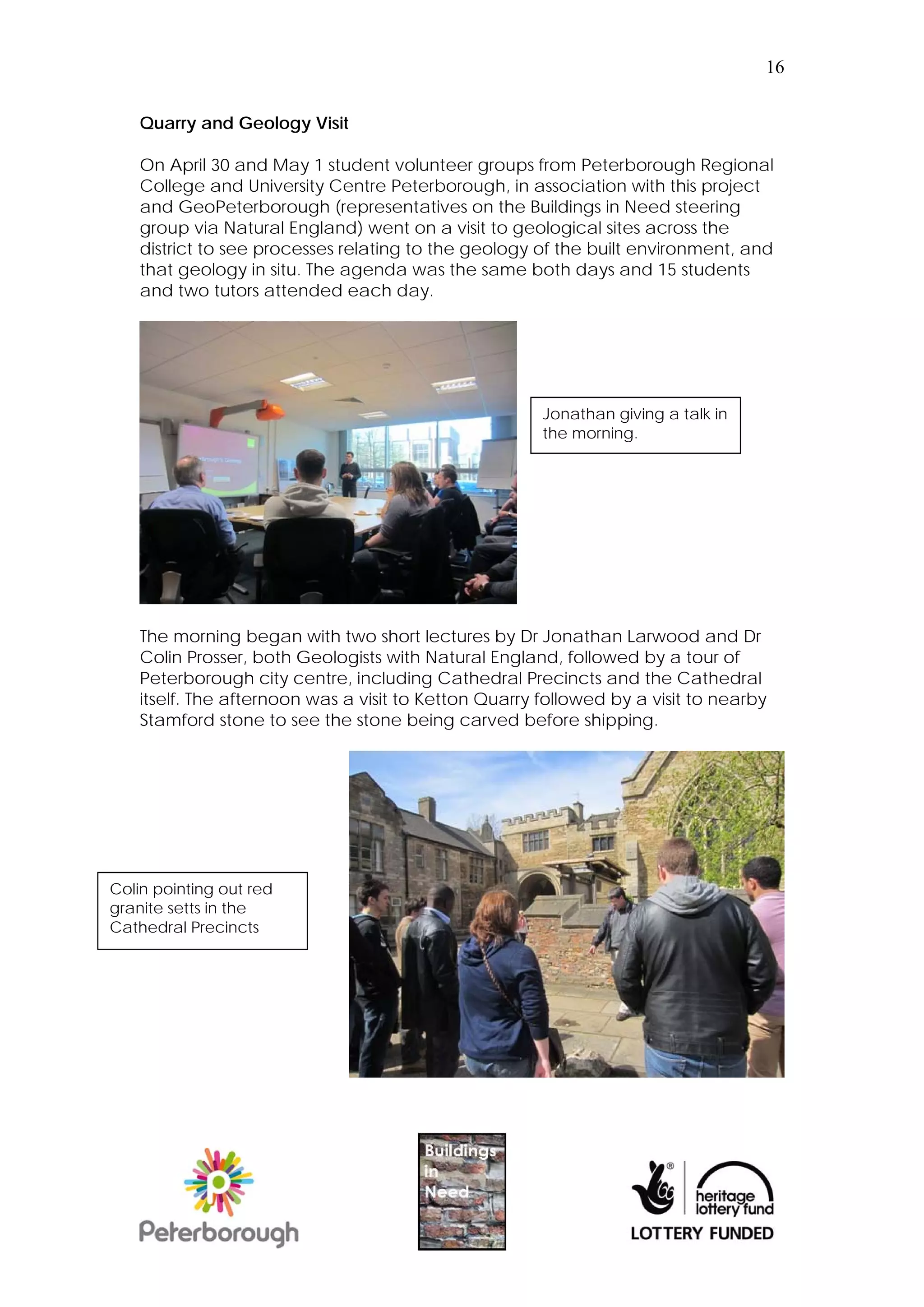

      Quarry Visit                                                           16

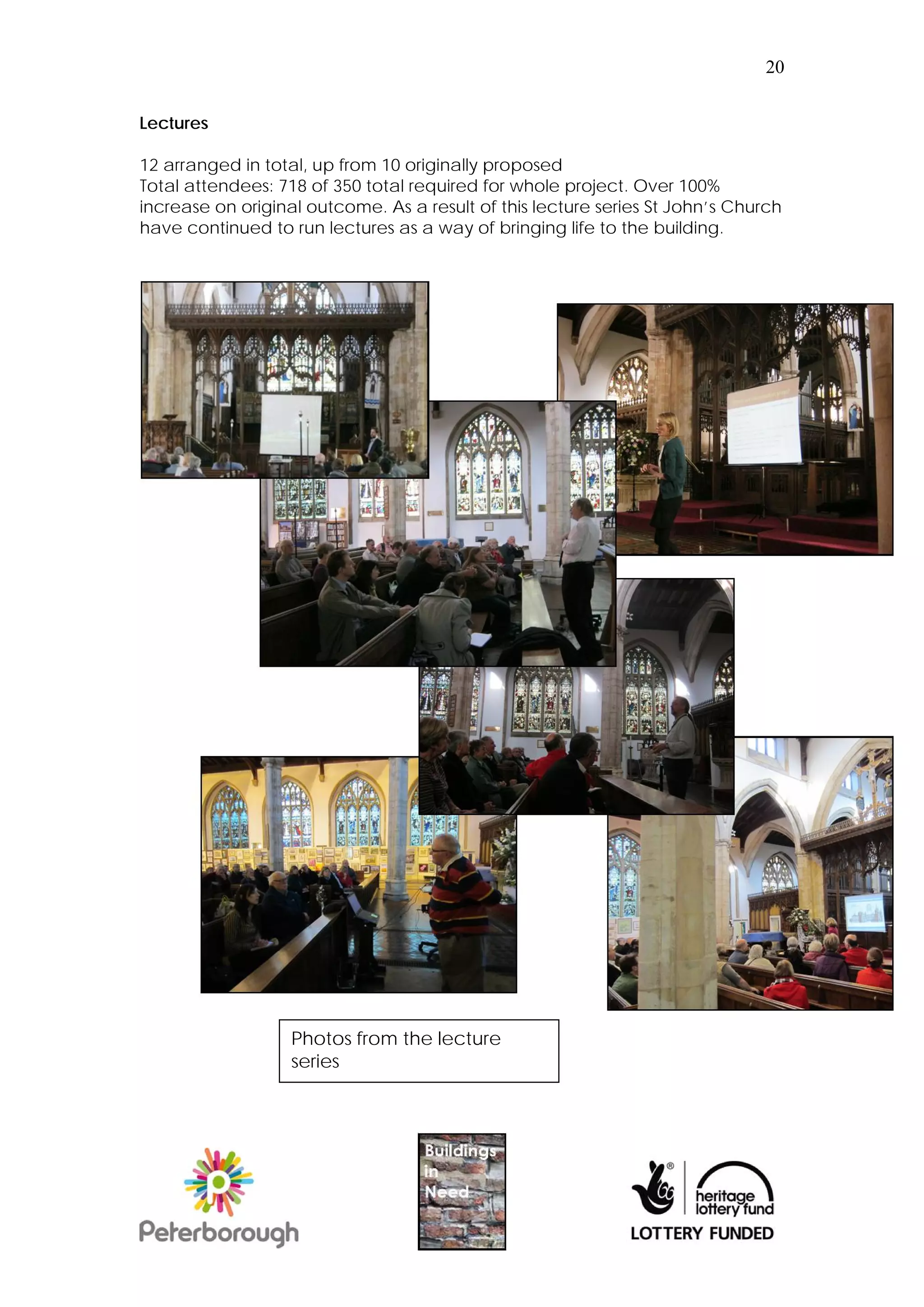

      Lectures                                                               20
      Masterclasses                                                          22
4) Building Surveys                                                           26

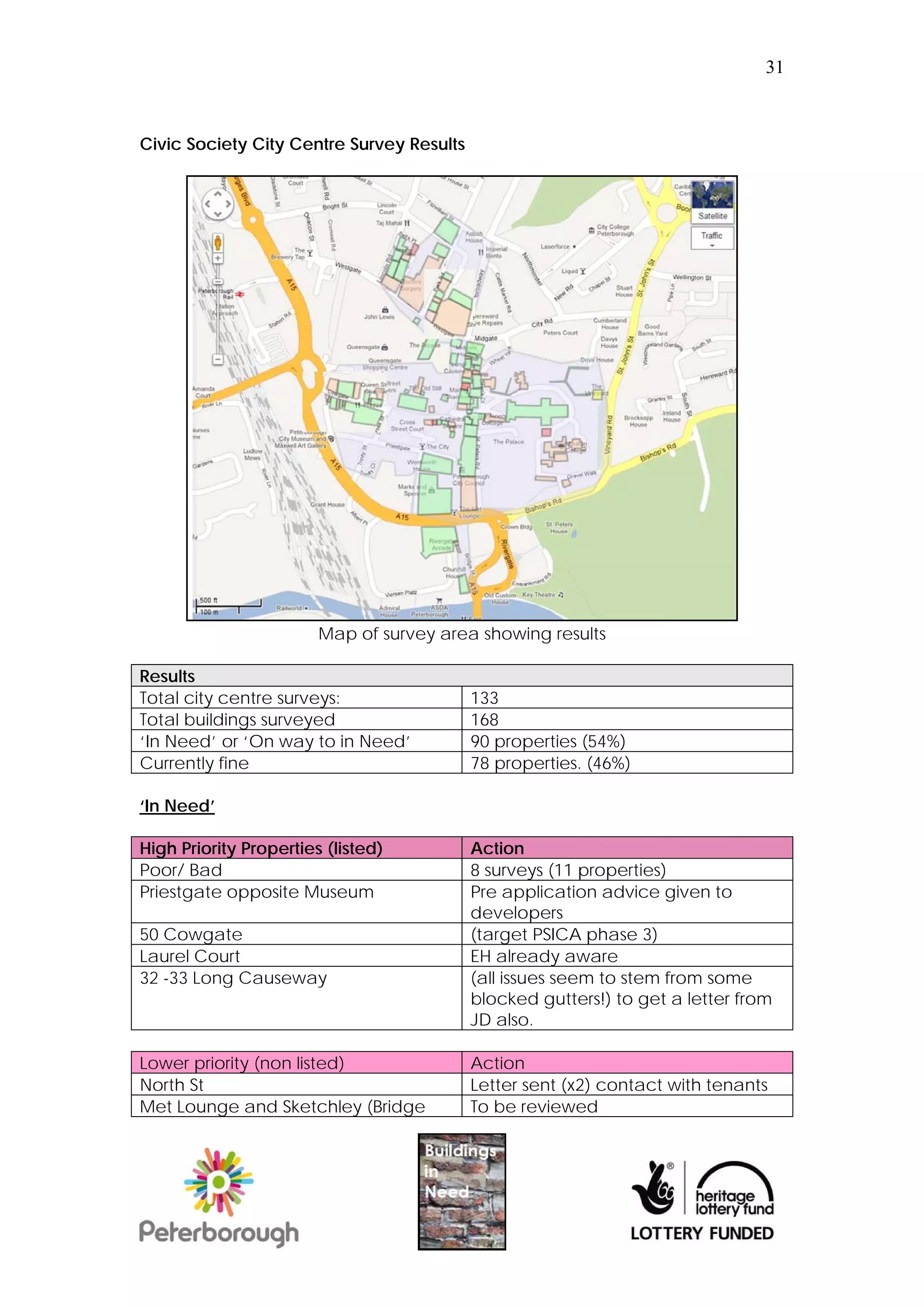

      Civic Society City Centre Survey Results                               31
      Verification and summary of results by David Turnock, Architect        33
5) Promotion and Celebration                                                  37

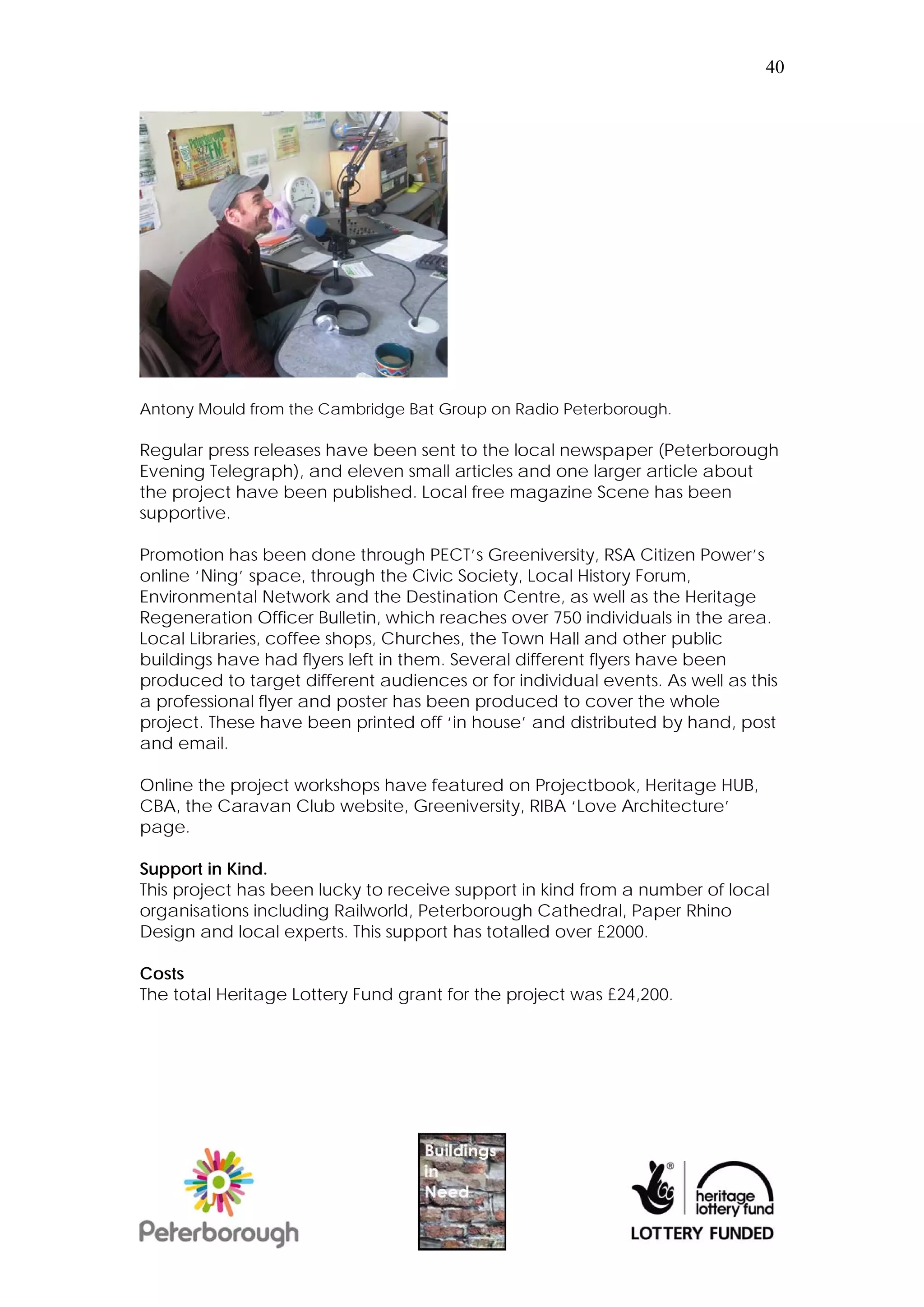

Press coverage                                                                37

Support in Kind                                                               40

Costs                                                                         40

Buildings in Need Toolkit                                                     42

   1.   Introduction                                                          43
   2.   How to use the Toolkit                                                46
   3.   Sources of Information                                                54
   4.   Appendix A: Letter for Volunteers                                     55
   5.   Appendix B: Survey Form                                               56

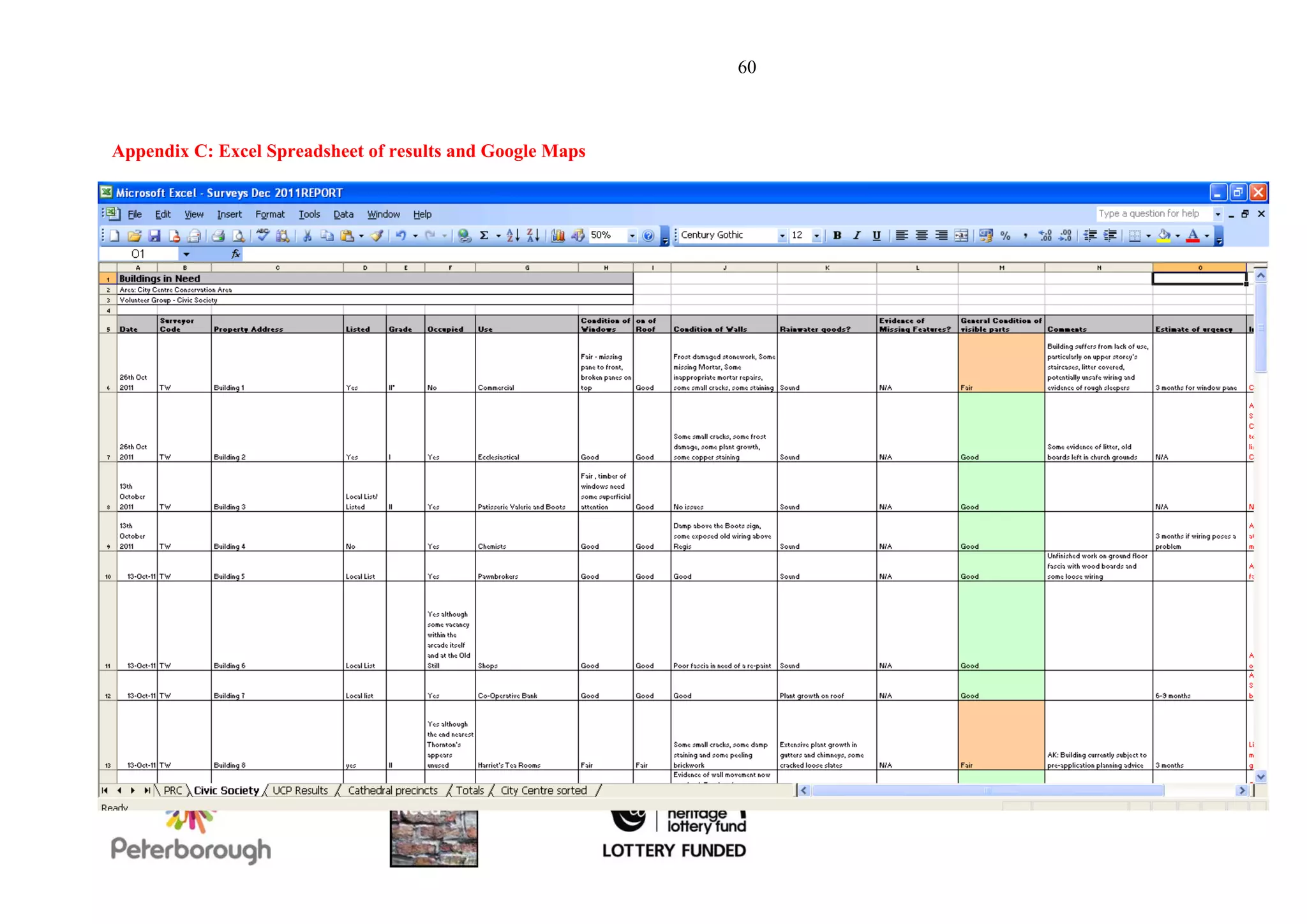

   6.   Appendix C: Excel Spreadsheet of results and Google Maps              60
4
5

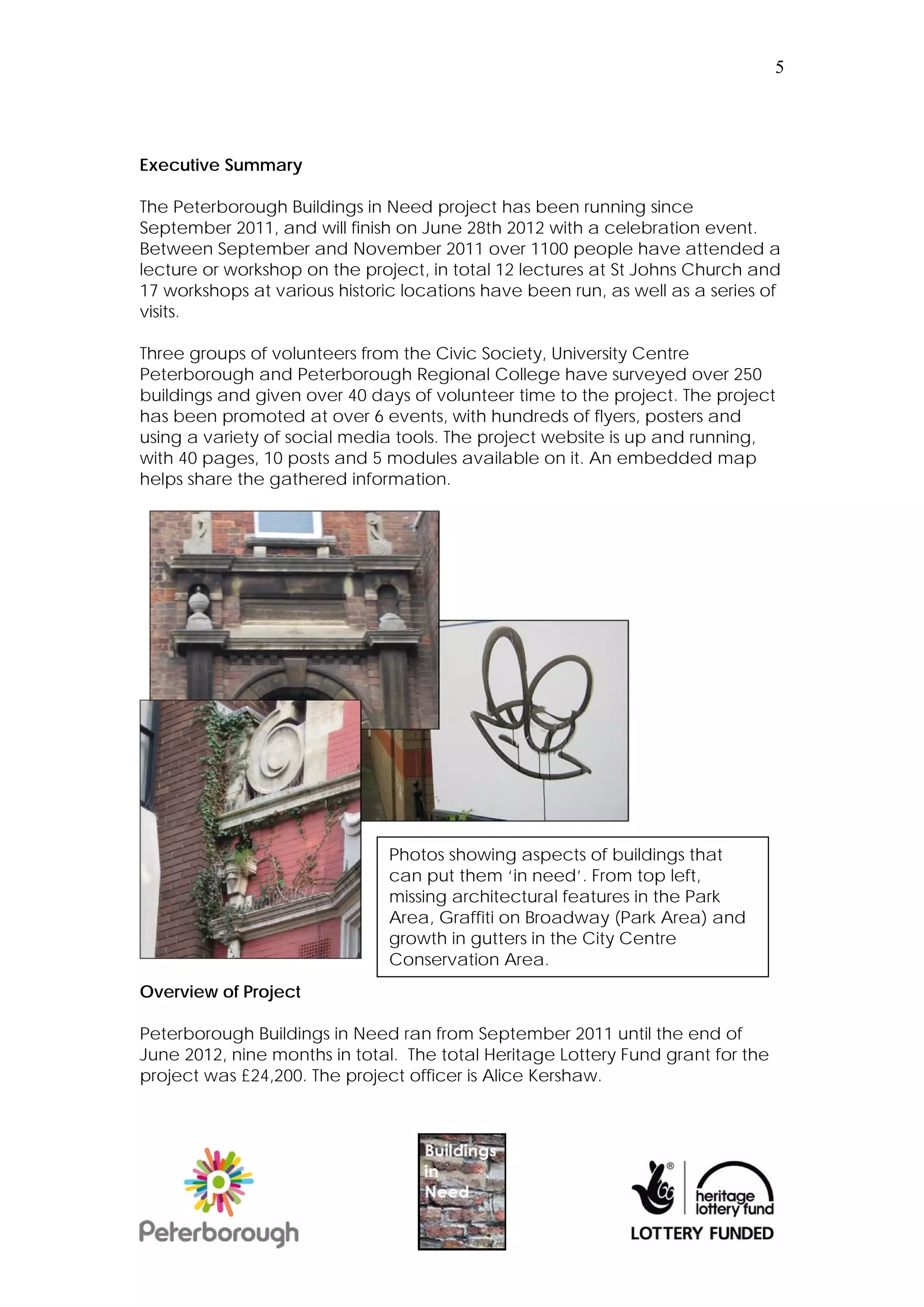

Executive Summary

The Peterborough Buildings in Need project has been running since
September 2011, and will finish on June 28th 2012 with a celebration event.
Between September and November 2011 over 1100 people have attended a
lecture or workshop on the project, in total 12 lectures at St Johns Church and
17 workshops at various historic locations have been run, as well as a series of
visits.

Three groups of volunteers from the Civic Society, University Centre
Peterborough and Peterborough Regional College have surveyed over 250
buildings and given over 40 days of volunteer time to the project. The project
has been promoted at over 6 events, with hundreds of flyers, posters and
using a variety of social media tools. The project website is up and running,
with 40 pages, 10 posts and 5 modules available on it. An embedded map
helps share the gathered information.

                               Photos showing aspects of buildings that
                               can put them ‘in need’. From top left,
                               missing architectural features in the Park
                               Area, Graffiti on Broadway (Park Area) and
                               growth in gutters in the City Centre
                               Conservation Area.
Overview of Project

Peterborough Buildings in Need ran from September 2011 until the end of
June 2012, nine months in total. The total Heritage Lottery Fund grant for the
project was £24,200. The project officer is Alice Kershaw.
6

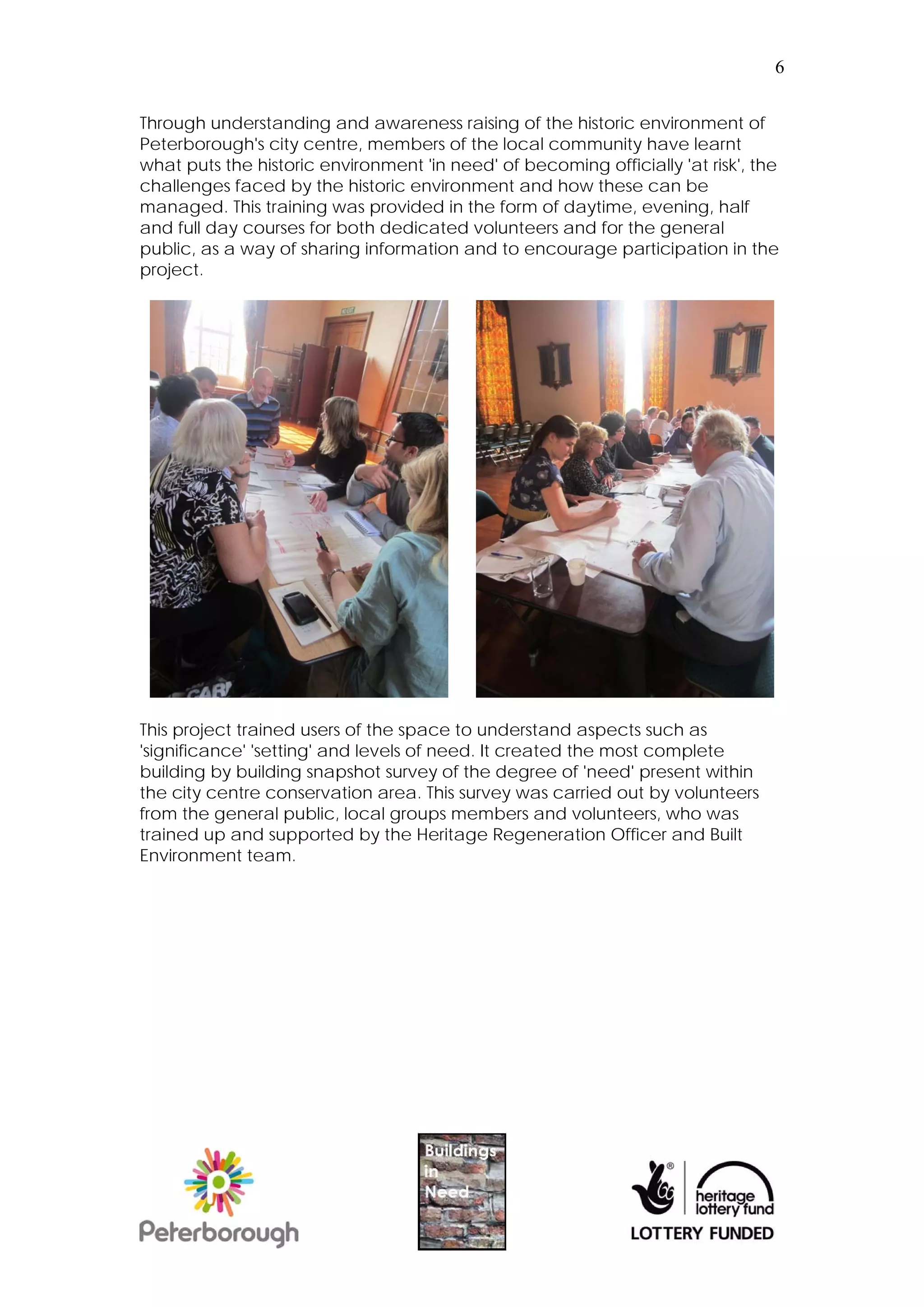

Through understanding and awareness raising of the historic environment of
Peterborough's city centre, members of the local community have learnt
what puts the historic environment 'in need' of becoming officially 'at risk', the
challenges faced by the historic environment and how these can be
managed. This training was provided in the form of daytime, evening, half
and full day courses for both dedicated volunteers and for the general
public, as a way of sharing information and to encourage participation in the
project.

This project trained users of the space to understand aspects such as
'significance' 'setting' and levels of need. It created the most complete
building by building snapshot survey of the degree of 'need' present within
the city centre conservation area. This survey was carried out by volunteers
from the general public, local groups members and volunteers, who was
trained up and supported by the Heritage Regeneration Officer and Built
Environment team.
7

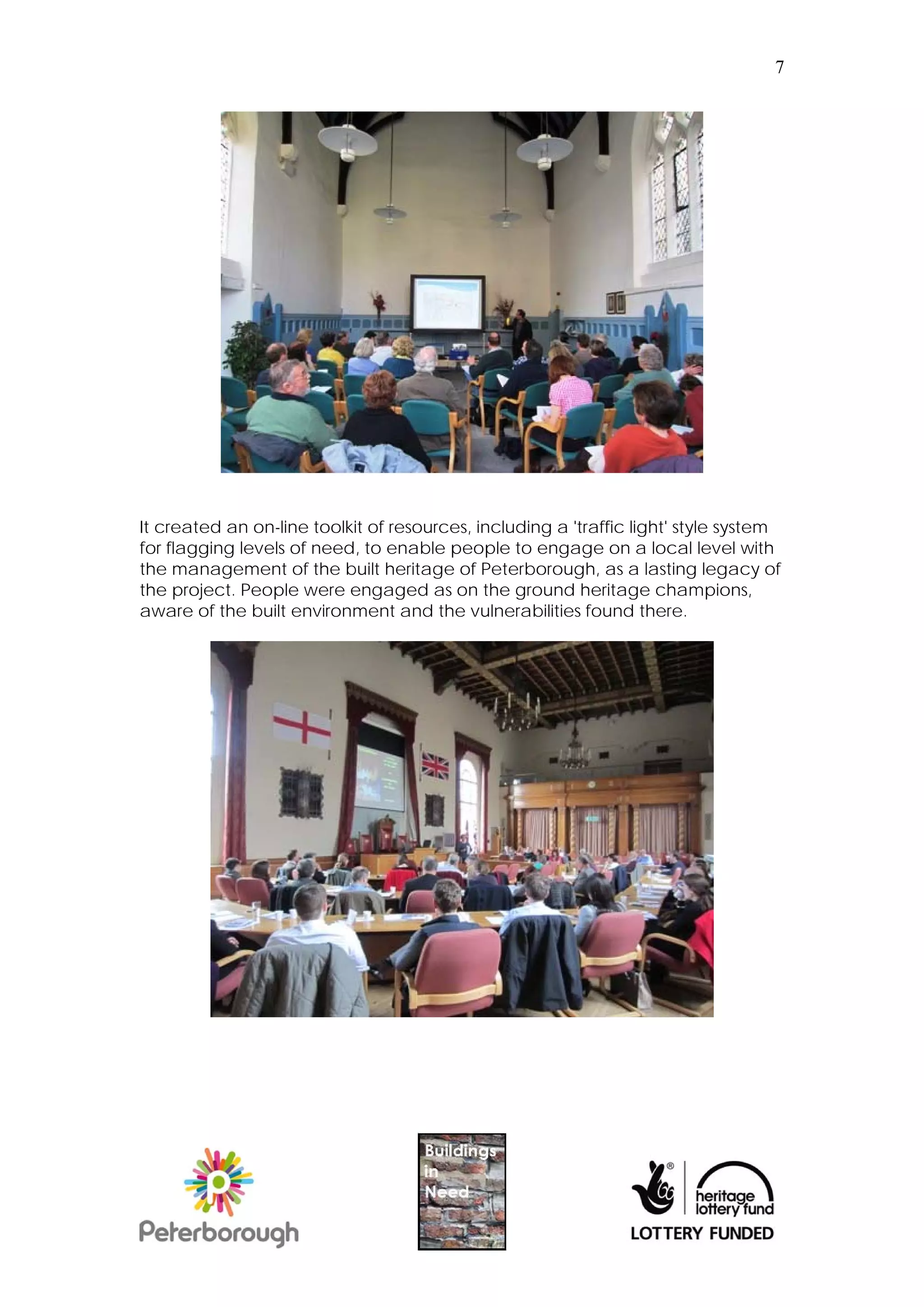

It created an on-line toolkit of resources, including a 'traffic light' style system
for flagging levels of need, to enable people to engage on a local level with
the management of the built heritage of Peterborough, as a lasting legacy of
the project. People were engaged as on the ground heritage champions,
aware of the built environment and the vulnerabilities found there.
8

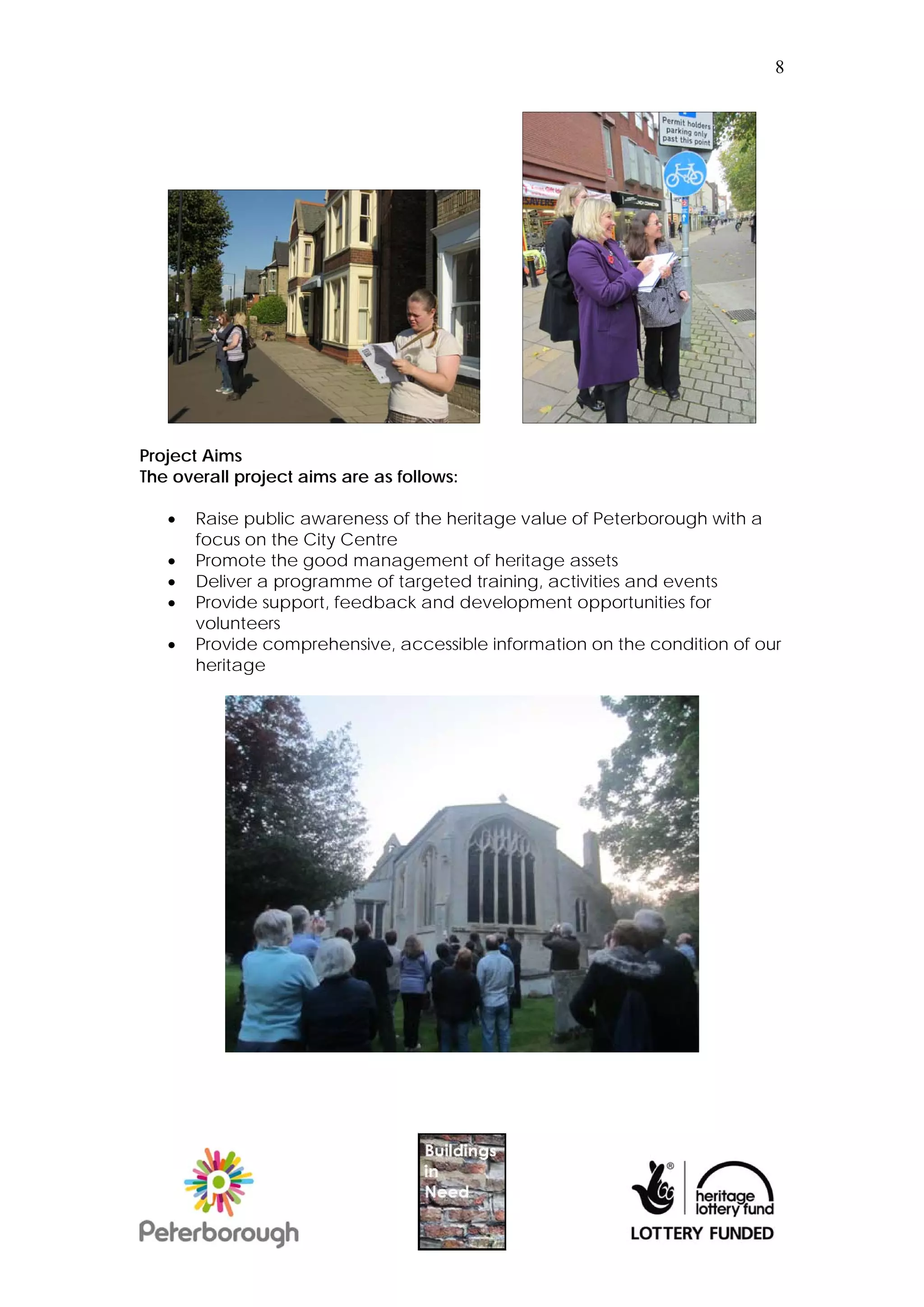

Project Aims
The overall project aims are as follows:

      Raise public awareness of the heritage value of Peterborough with a
       focus on the City Centre
      Promote the good management of heritage assets
      Deliver a programme of targeted training, activities and events
      Provide support, feedback and development opportunities for
       volunteers
      Provide comprehensive, accessible information on the condition of our
       heritage
9

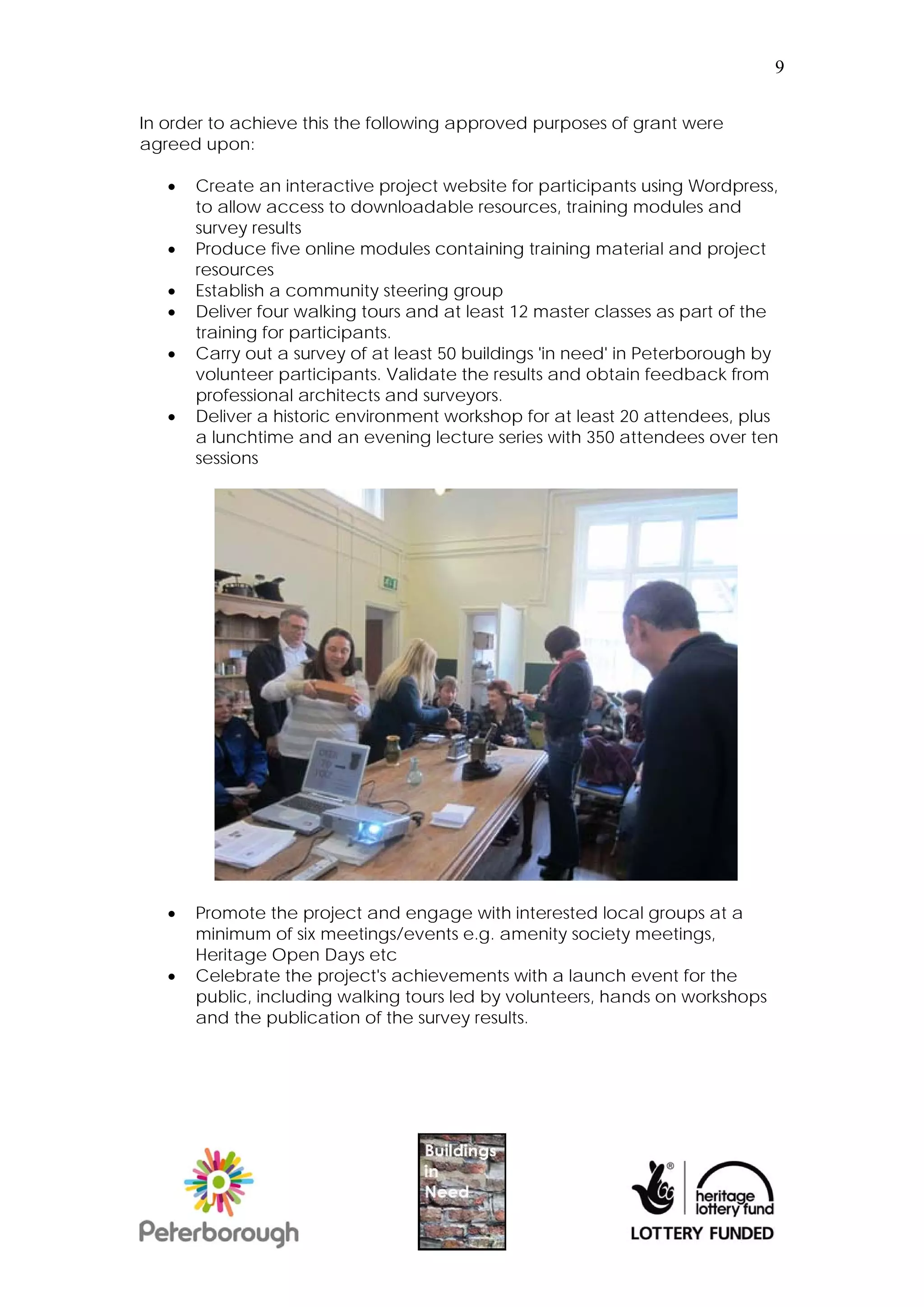

In order to achieve this the following approved purposes of grant were
agreed upon:

      Create an interactive project website for participants using Wordpress,
       to allow access to downloadable resources, training modules and
       survey results
      Produce five online modules containing training material and project
       resources
      Establish a community steering group
      Deliver four walking tours and at least 12 master classes as part of the
       training for participants.
      Carry out a survey of at least 50 buildings 'in need' in Peterborough by
       volunteer participants. Validate the results and obtain feedback from
       professional architects and surveyors.
      Deliver a historic environment workshop for at least 20 attendees, plus
       a lunchtime and an evening lecture series with 350 attendees over ten
       sessions

      Promote the project and engage with interested local groups at a
       minimum of six meetings/events e.g. amenity society meetings,
       Heritage Open Days etc
      Celebrate the project's achievements with a launch event for the
       public, including walking tours led by volunteers, hands on workshops
       and the publication of the survey results.
10

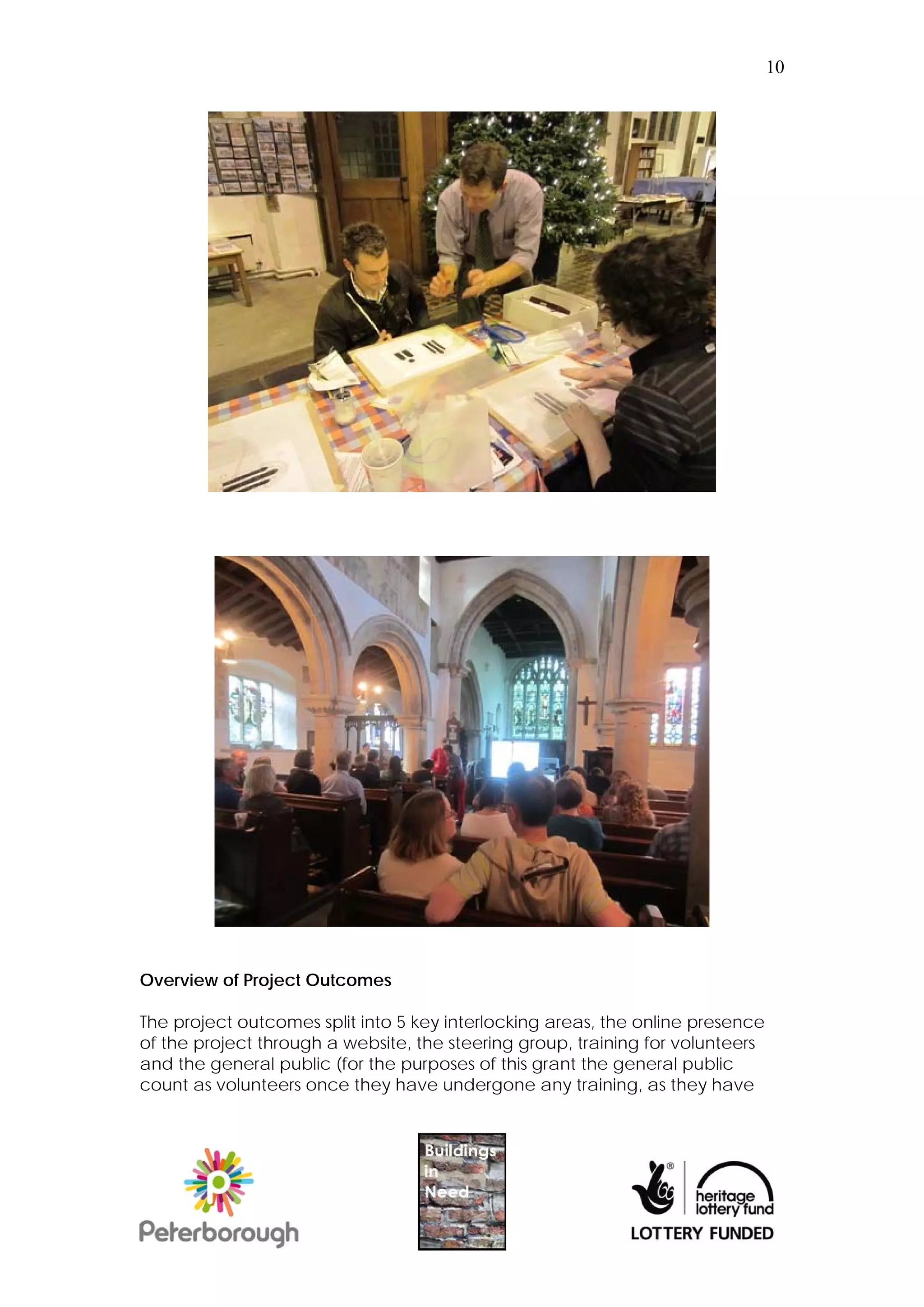

Overview of Project Outcomes

The project outcomes split into 5 key interlocking areas, the online presence
of the project through a website, the steering group, training for volunteers
and the general public (for the purposes of this grant the general public
count as volunteers once they have undergone any training, as they have
11

given up their time for the project), building surveys and the promotion and
celebration of the project as a whole.

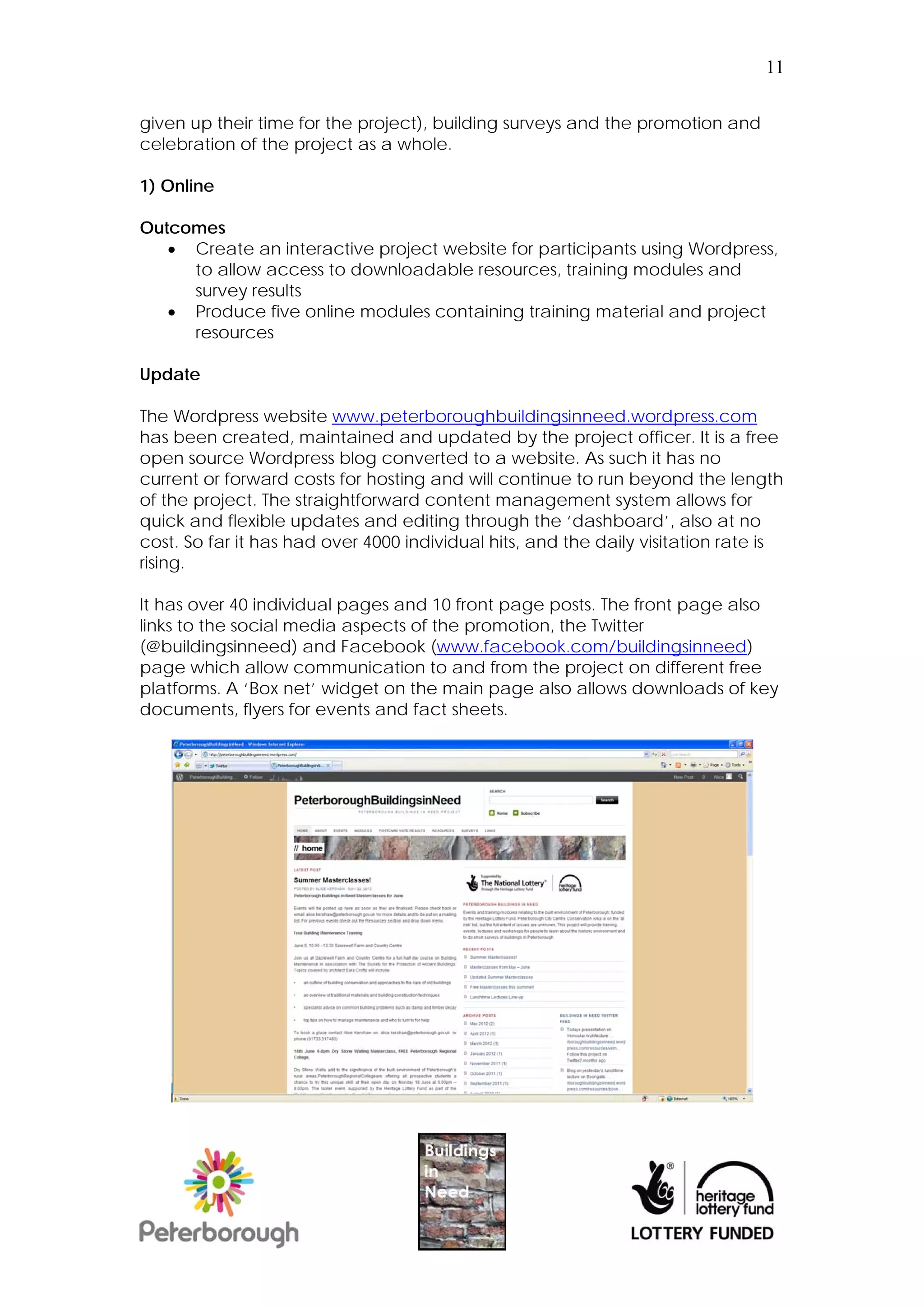

1) Online

Outcomes
    Create an interactive project website for participants using Wordpress,
     to allow access to downloadable resources, training modules and
     survey results
    Produce five online modules containing training material and project
     resources

Update

The Wordpress website www.peterboroughbuildingsinneed.wordpress.com
has been created, maintained and updated by the project officer. It is a free
open source Wordpress blog converted to a website. As such it has no
current or forward costs for hosting and will continue to run beyond the length
of the project. The straightforward content management system allows for
quick and flexible updates and editing through the ‘dashboard’, also at no

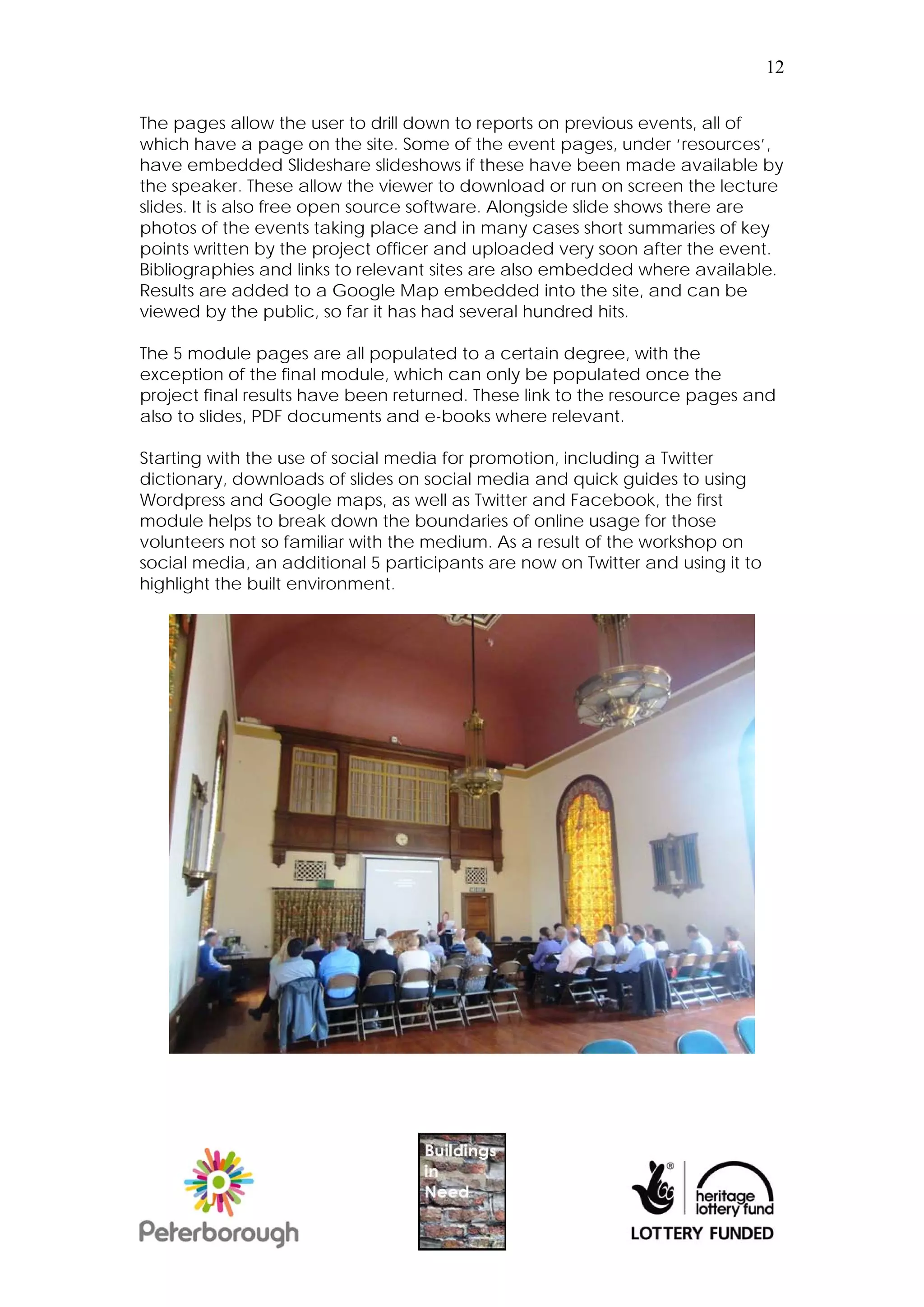

cost. So far it has had over 4000 individual hits, and the daily visitation rate is
rising.

It has over 40 individual pages and 10 front page posts. The front page also
links to the social media aspects of the promotion, the Twitter
(@buildingsinneed) and Facebook (www.facebook.com/buildingsinneed)
page which allow communication to and from the project on different free
platforms. A ‘Box net’ widget on the main page also allows downloads of key
documents, flyers for events and fact sheets.
12

The pages allow the user to drill down to reports on previous events, all of
which have a page on the site. Some of the event pages, under ‘resources’,
have embedded Slideshare slideshows if these have been made available by
the speaker. These allow the viewer to download or run on screen the lecture
slides. It is also free open source software. Alongside slide shows there are
photos of the events taking place and in many cases short summaries of key
points written by the project officer and uploaded very soon after the event.
Bibliographies and links to relevant sites are also embedded where available.
Results are added to a Google Map embedded into the site, and can be
viewed by the public, so far it has had several hundred hits.

The 5 module pages are all populated to a certain degree, with the
exception of the final module, which can only be populated once the
project final results have been returned. These link to the resource pages and
also to slides, PDF documents and e-books where relevant.

Starting with the use of social media for promotion, including a Twitter
dictionary, downloads of slides on social media and quick guides to using
Wordpress and Google maps, as well as Twitter and Facebook, the first
module helps to break down the boundaries of online usage for those
volunteers not so familiar with the medium. As a result of the workshop on
social media, an additional 5 participants are now on Twitter and using it to
highlight the built environment.
13

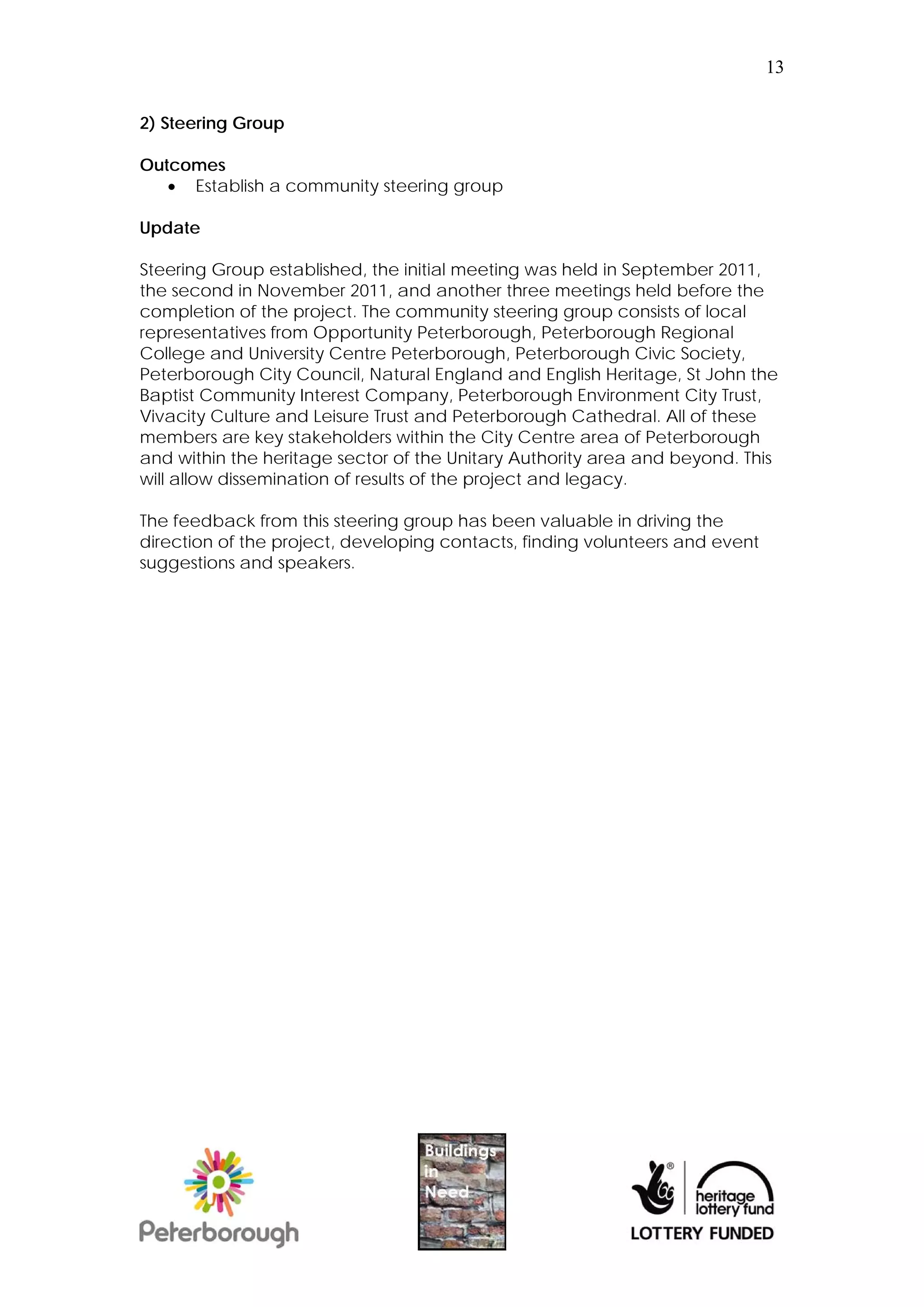

2) Steering Group

Outcomes
    Establish a community steering group

Update

Steering Group established, the initial meeting was held in September 2011,
the second in November 2011, and another three meetings held before the
completion of the project. The community steering group consists of local
representatives from Opportunity Peterborough, Peterborough Regional
College and University Centre Peterborough, Peterborough Civic Society,
Peterborough City Council, Natural England and English Heritage, St John the
Baptist Community Interest Company, Peterborough Environment City Trust,
Vivacity Culture and Leisure Trust and Peterborough Cathedral. All of these
members are key stakeholders within the City Centre area of Peterborough
and within the heritage sector of the Unitary Authority area and beyond. This
will allow dissemination of results of the project and legacy.

The feedback from this steering group has been valuable in driving the
direction of the project, developing contacts, finding volunteers and event
suggestions and speakers.
14

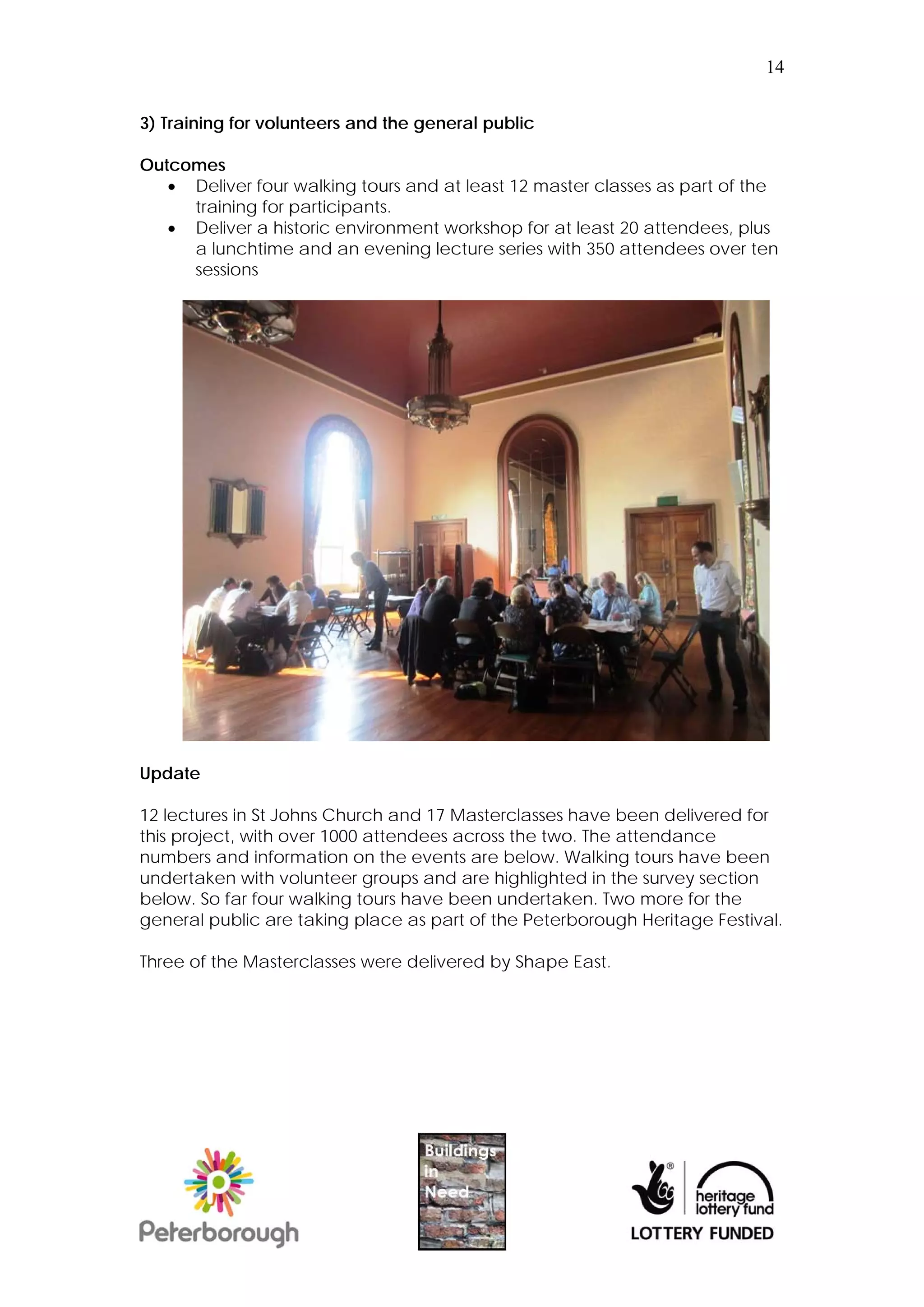

3) Training for volunteers and the general public

Outcomes
    Deliver four walking tours and at least 12 master classes as part of the
     training for participants.
    Deliver a historic environment workshop for at least 20 attendees, plus
     a lunchtime and an evening lecture series with 350 attendees over ten
     sessions

Update

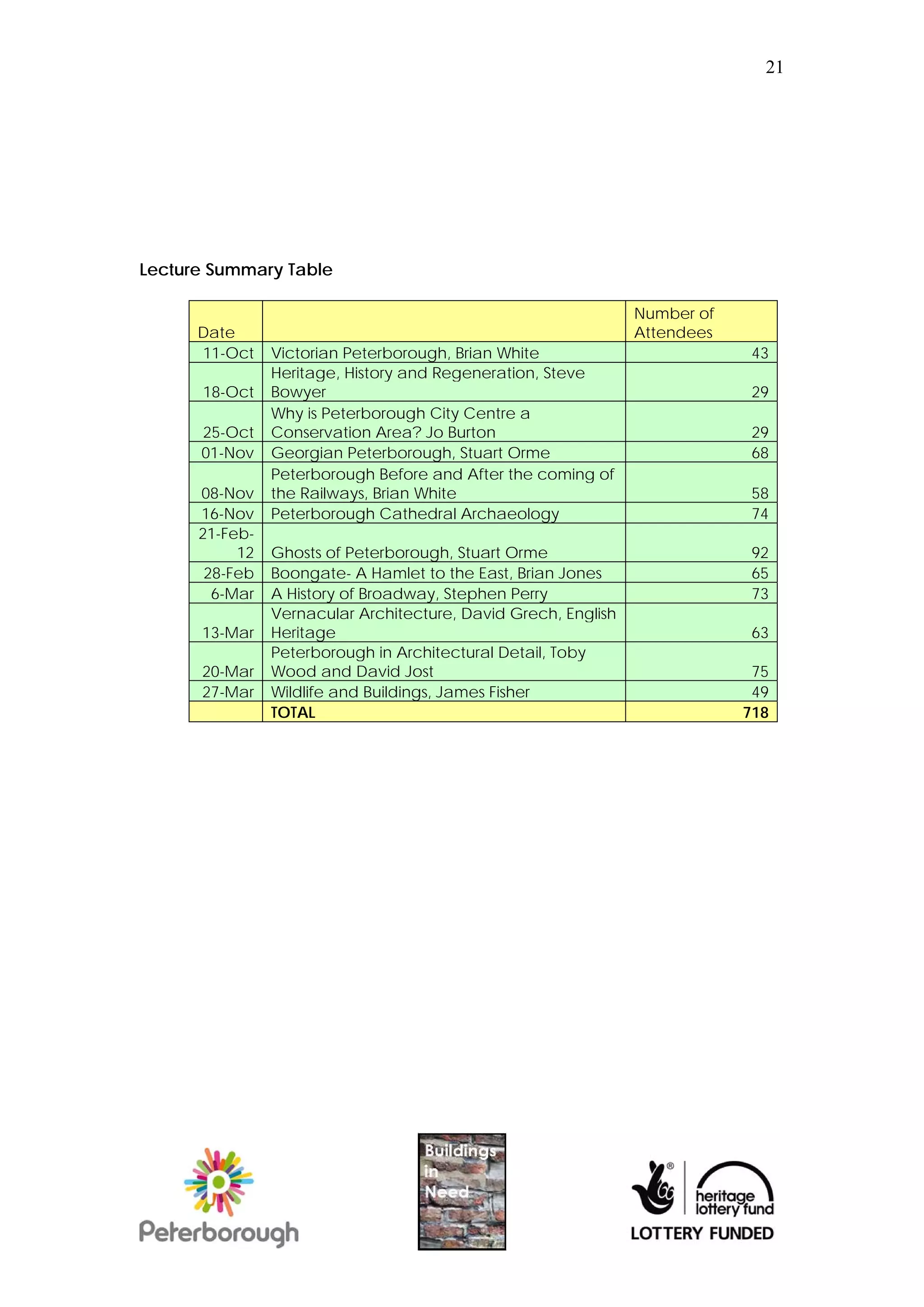

12 lectures in St Johns Church and 17 Masterclasses have been delivered for
this project, with over 1000 attendees across the two. The attendance
numbers and information on the events are below. Walking tours have been

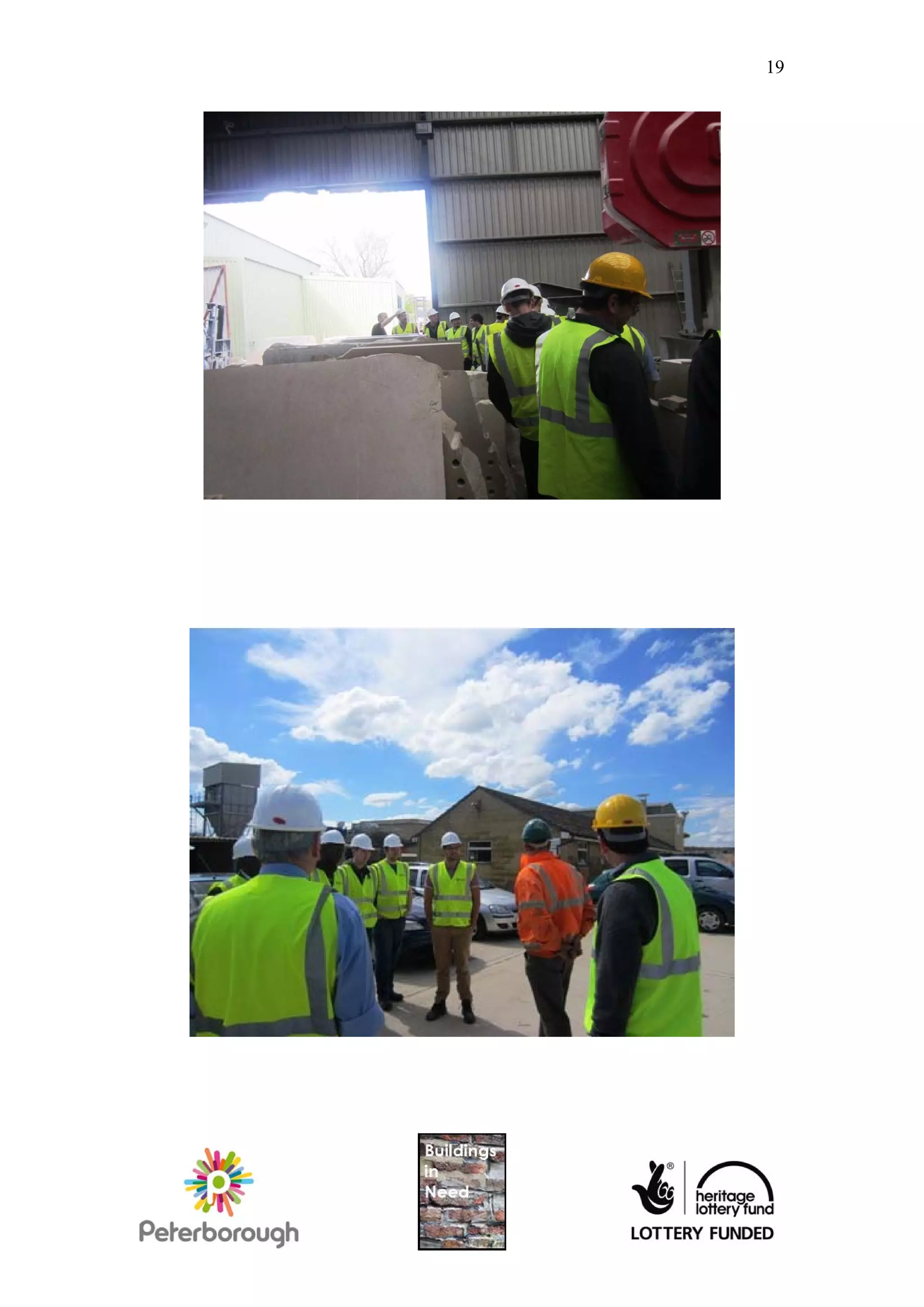

undertaken with volunteer groups and are highlighted in the survey section
below. So far four walking tours have been undertaken. Two more for the
general public are taking place as part of the Peterborough Heritage Festival.

Three of the Masterclasses were delivered by Shape East.
15

About Shape East:

SHAPE EAST is a Centre for Design Excellence and Sustainable Innovation
based in the East of England. We are dedicated to providing a positive
influence on the quality of urban design and the built environment through
supporting the professional community, engaging the public and facilitating
debate and understanding between the two. We do this by running a diverse
and ever-changing range of events; from professional training seminars to
public lectures, local walking tours to school model-making workshops.

Our central objectives are to:

      Inspire and excite people about the built environment and help them
       see it through fresh eyes.

      Increase understanding of the importance of good planning, urban
       design, architecture and construction.

      Encourage people to participate in the planning and other processes
       which shape change in their communities.

      Prepare the ground for the future by engaging children and young
       people in built environment issues.

http://www.shape-east.org.uk/
16

    Quarry and Geology Visit

    On April 30 and May 1 student volunteer groups from Peterborough Regional
    College and University Centre Peterborough, in association with this project
    and GeoPeterborough (representatives on the Buildings in Need steering
    group via Natural England) went on a visit to geological sites across the
    district to see processes relating to the geology of the built environment, and
    that geology in situ. The agenda was the same both days and 15 students
    and two tutors attended each day.

                                                       Jonathan giving a talk in
                                                       the morning.

    The morning began with two short lectures by Dr Jonathan Larwood and Dr
    Colin Prosser, both Geologists with Natural England, followed by a tour of
    Peterborough city centre, including Cathedral Precincts and the Cathedral
    itself. The afternoon was a visit to Ketton Quarry followed by a visit to nearby
    Stamford stone to see the stone being carved before shipping.

Colin pointing out red
granite setts in the
Cathedral Precincts
17

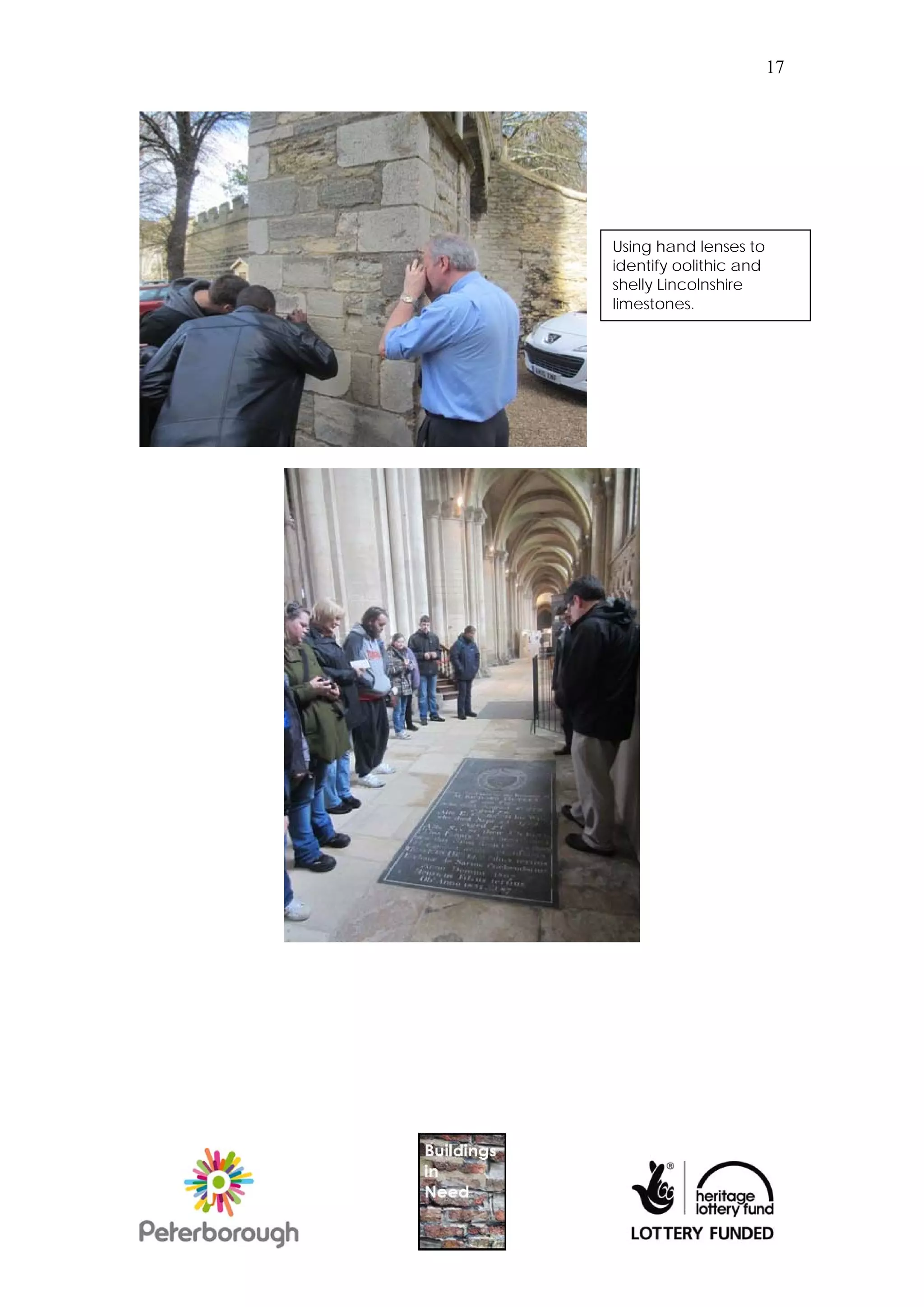

Using hand lenses to
identify oolithic and
shelly Lincolnshire
limestones.
18

Photos from the
GeoPeterborough days
19
20

Lectures

12 arranged in total, up from 10 originally proposed
Total attendees: 718 of 350 total required for whole project. Over 100%
increase on original outcome. As a result of this lecture series St John’s Church
have continued to run lectures as a way of bringing life to the building.

                   Photos from the lecture
                   series
21

Lecture Summary Table

                                                                Number of
      Date                                                      Attendees
      11-Oct    Victorian Peterborough, Brian White                          43
                Heritage, History and Regeneration, Steve
      18-Oct    Bowyer                                                       29
                Why is Peterborough City Centre a
      25-Oct    Conservation Area? Jo Burton                                 29
      01-Nov    Georgian Peterborough, Stuart Orme                           68
                Peterborough Before and After the coming of
      08-Nov    the Railways, Brian White                                    58
      16-Nov    Peterborough Cathedral Archaeology                           74
      21-Feb-
           12   Ghosts of Peterborough, Stuart Orme                          92
       28-Feb   Boongate- A Hamlet to the East, Brian Jones                  65
        6-Mar   A History of Broadway, Stephen Perry                         73
                Vernacular Architecture, David Grech, English
      13-Mar    Heritage                                                     63
                Peterborough in Architectural Detail, Toby
      20-Mar    Wood and David Jost                                          75
      27-Mar    Wildlife and Buildings, James Fisher                         49
                TOTAL                                                       718
22

Masterclasses

The Masterclasses also have a feedback element to them. Every attendee is
given a feedback form and asked to fill it out.

This has been overwhelmingly positive, with the content, pace and feedback
on the tutors coming in at 100 % good or excellent for every class. Where
feedback has been given on room layouts and lighting that is not up to
standard this has been taken into account for future Masterclasses and has
directly informed them. The attendance at Masterclasses has to be smaller
than the lectures and has been nearly100% full so far in terms of capacity.

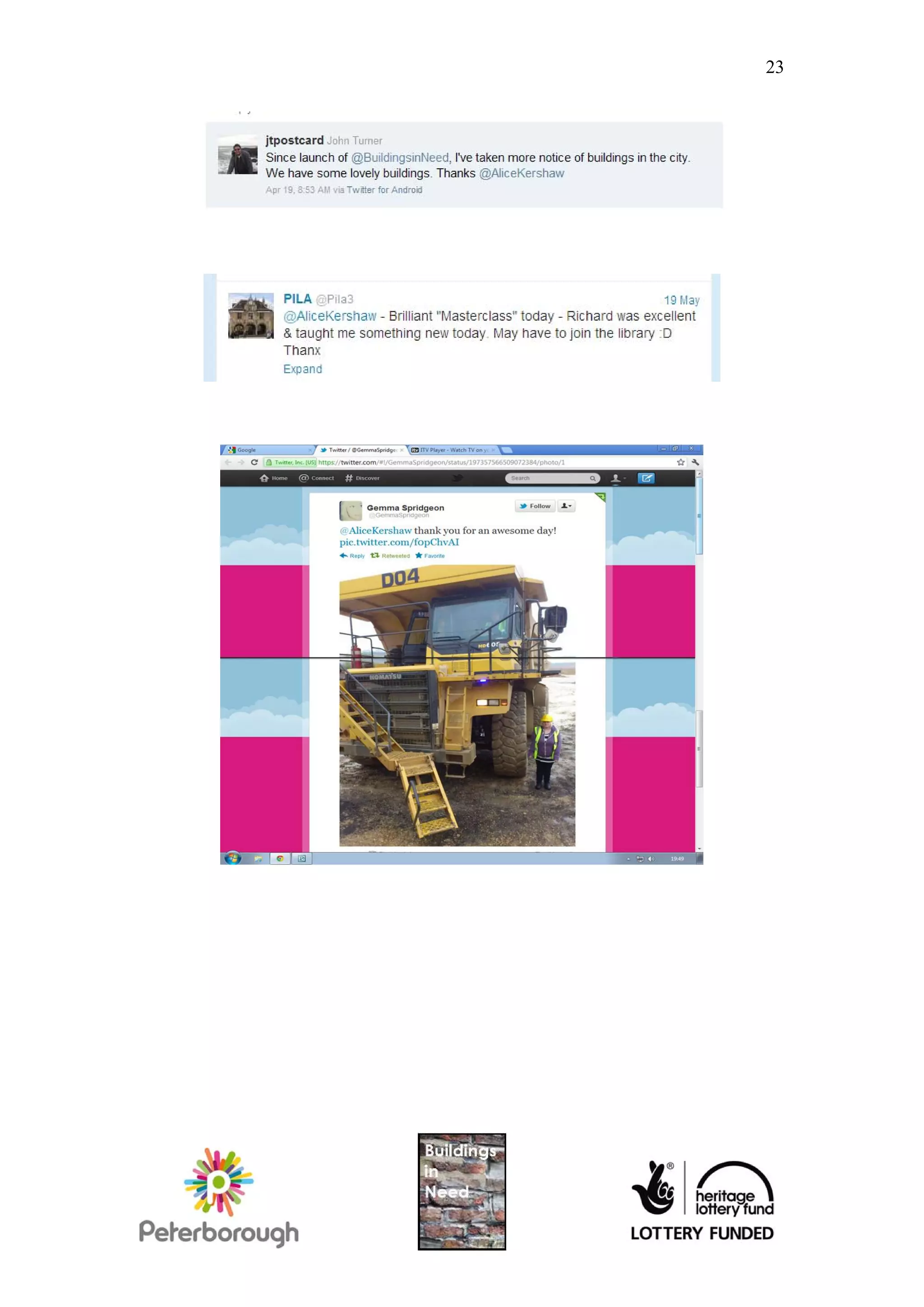

Feedback has also been given through Twitter, as can be seen below from
two Masterclass attendees and the Quarry visit.
23
24

Total number of Masterclasses run is 17 from the original 12 suggested
including one Heritage workshop run by SPAB out at Sacrewell Farm.
Total attendees of Masterclasses: 402
25

Masterclass Summary Table

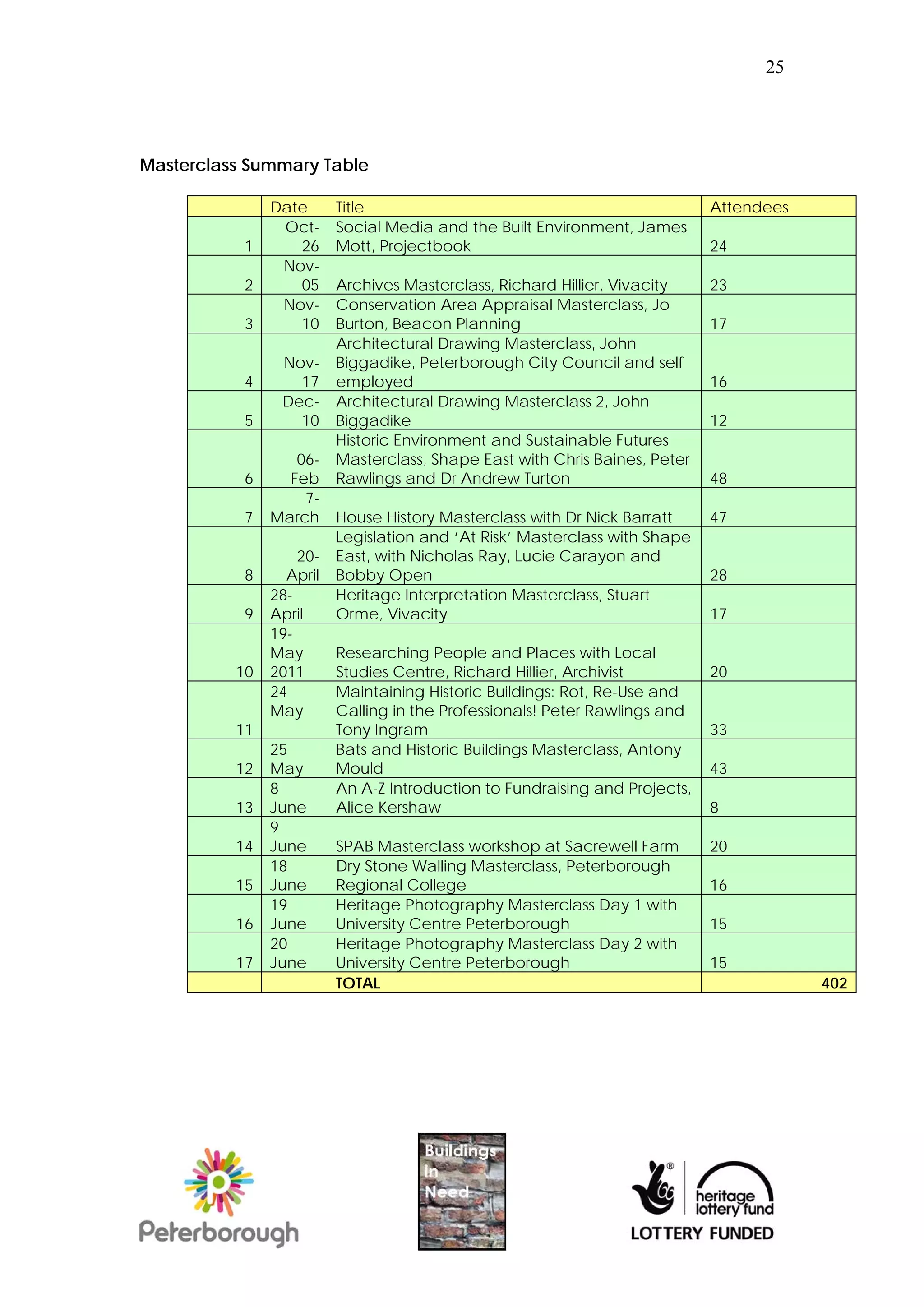

               Date      Title                                              Attendees
                Oct-     Social Media and the Built Environment, James
           1      26     Mott, Projectbook                                  24
                Nov-
           2      05     Archives Masterclass, Richard Hillier, Vivacity    23
                Nov-     Conservation Area Appraisal Masterclass, Jo
           3      10     Burton, Beacon Planning                            17
                         Architectural Drawing Masterclass, John
                Nov-     Biggadike, Peterborough City Council and self
           4      17     employed                                           16
                Dec-     Architectural Drawing Masterclass 2, John
           5      10     Biggadike                                          12
                         Historic Environment and Sustainable Futures
                  06-    Masterclass, Shape East with Chris Baines, Peter
           6     Feb     Rawlings and Dr Andrew Turton                      48
                   7-
           7   March     House History Masterclass with Dr Nick Barratt     47
                         Legislation and ‘At Risk’ Masterclass with Shape
                   20-   East, with Nicholas Ray, Lucie Carayon and
           8     April   Bobby Open                                         28
               28-       Heritage Interpretation Masterclass, Stuart
           9   April     Orme, Vivacity                                     17
               19-
               May       Researching People and Places with Local
          10   2011      Studies Centre, Richard Hillier, Archivist         20
               24        Maintaining Historic Buildings: Rot, Re-Use and
               May       Calling in the Professionals! Peter Rawlings and
          11             Tony Ingram                                        33
               25        Bats and Historic Buildings Masterclass, Antony
          12   May       Mould                                              43
               8         An A-Z Introduction to Fundraising and Projects,
          13   June      Alice Kershaw                                      8
               9
          14   June      SPAB Masterclass workshop at Sacrewell Farm        20
               18        Dry Stone Walling Masterclass, Peterborough
          15   June      Regional College                                   16
               19        Heritage Photography Masterclass Day 1 with
          16   June      University Centre Peterborough                     15
               20        Heritage Photography Masterclass Day 2 with
          17   June      University Centre Peterborough                     15
                         TOTAL                                                          402
26

4) Building Surveys

Outcomes
    Carry out a survey of at least 50 buildings 'in need' in Peterborough by
     volunteer participants. Validate the results and obtain feedback from
     professional architects and surveyors.

Update

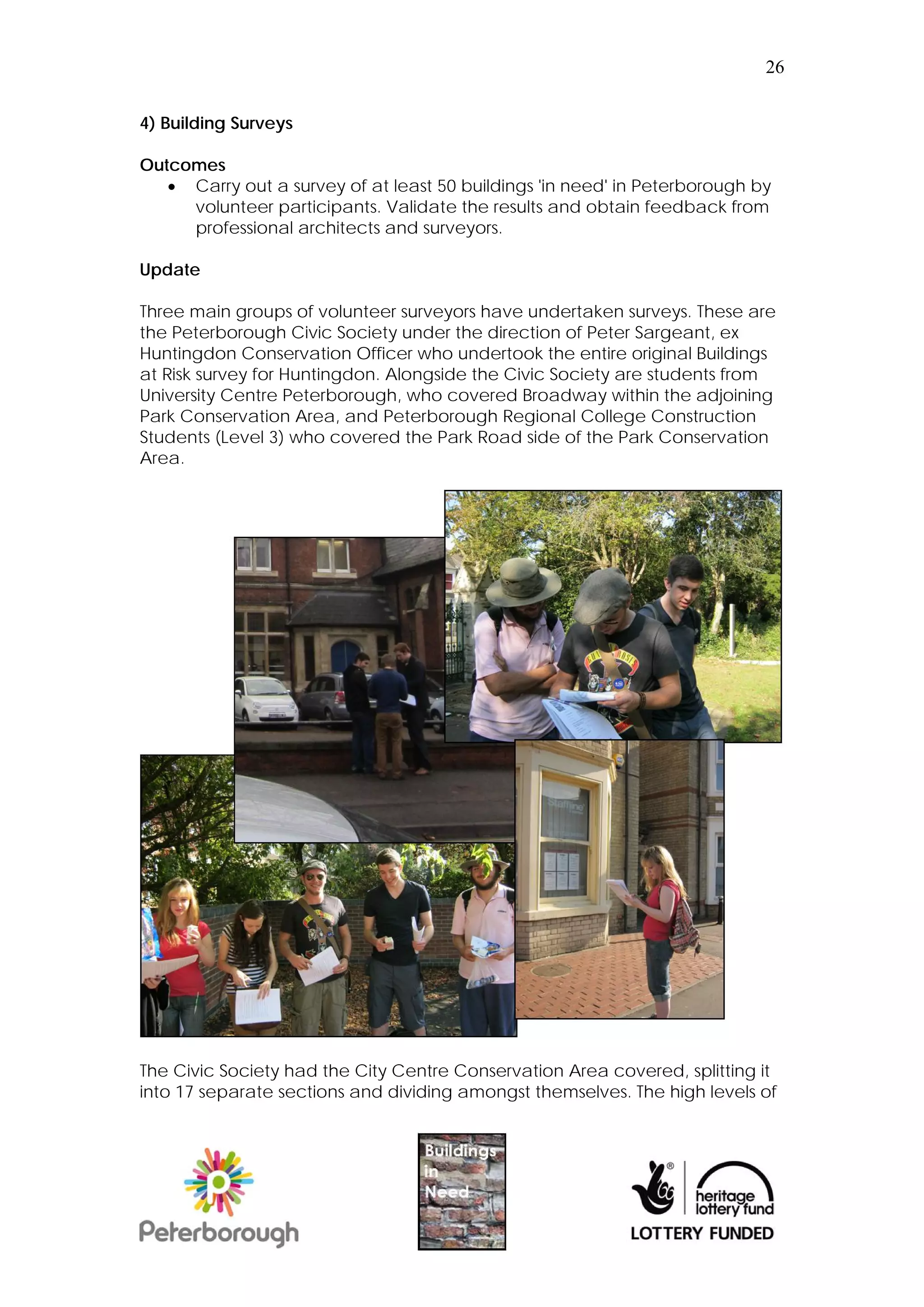

Three main groups of volunteer surveyors have undertaken surveys. These are
the Peterborough Civic Society under the direction of Peter Sargeant, ex
Huntingdon Conservation Officer who undertook the entire original Buildings
at Risk survey for Huntingdon. Alongside the Civic Society are students from
University Centre Peterborough, who covered Broadway within the adjoining
Park Conservation Area, and Peterborough Regional College Construction
Students (Level 3) who covered the Park Road side of the Park Conservation
Area.

The Civic Society had the City Centre Conservation Area covered, splitting it
into 17 separate sections and dividing amongst themselves. The high levels of
27

expertise found within the society meant they could really hit the ground
running on this and results were returned by the end of October.

A group of 10 University Centre Peterborough Students undertook training and
a tour of Broadway Cemetery and Central Park with the project officer and

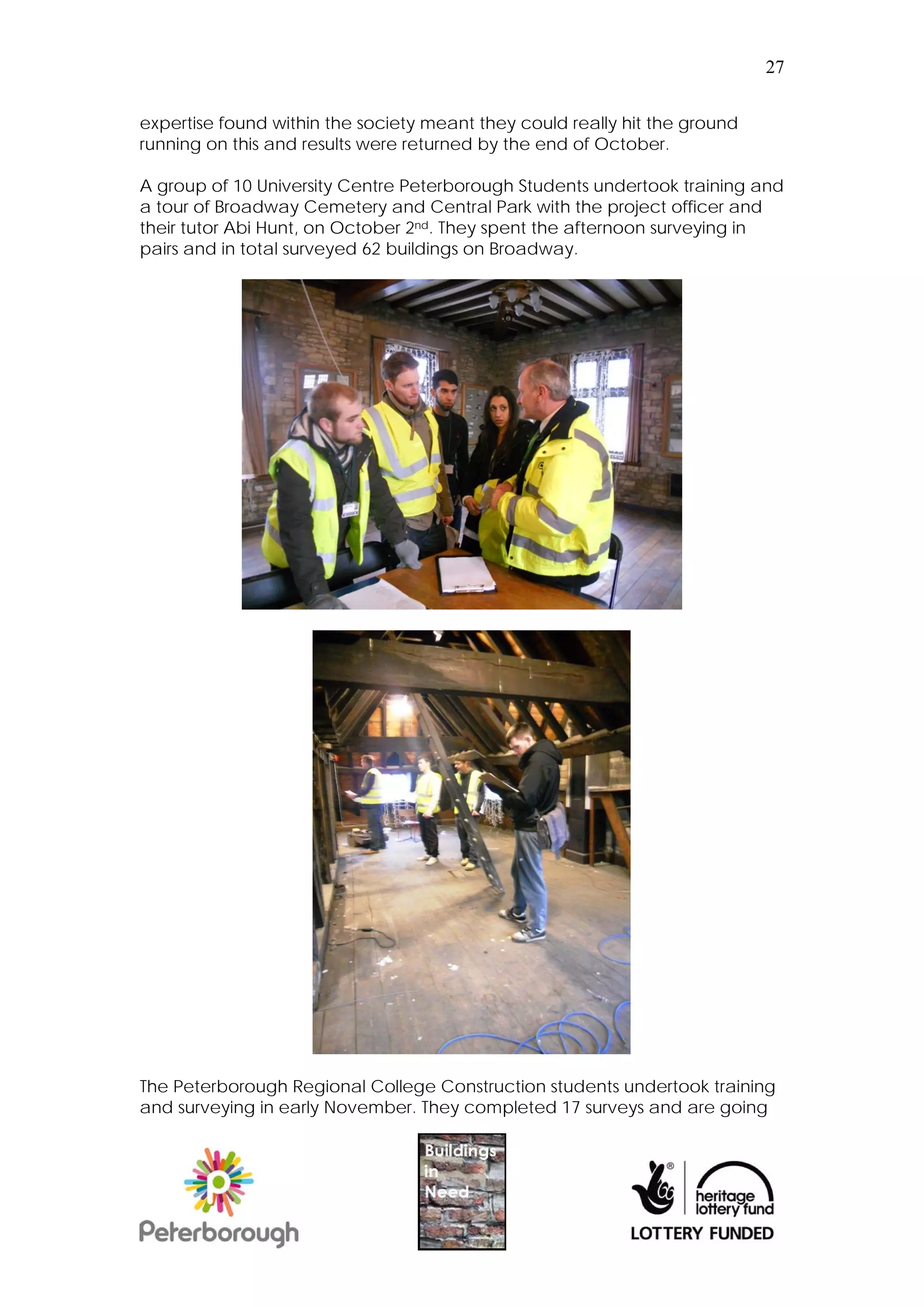

their tutor Abi Hunt, on October 2nd. They spent the afternoon surveying in
pairs and in total surveyed 62 buildings on Broadway.

The Peterborough Regional College Construction students undertook training
and surveying in early November. They completed 17 surveys and are going

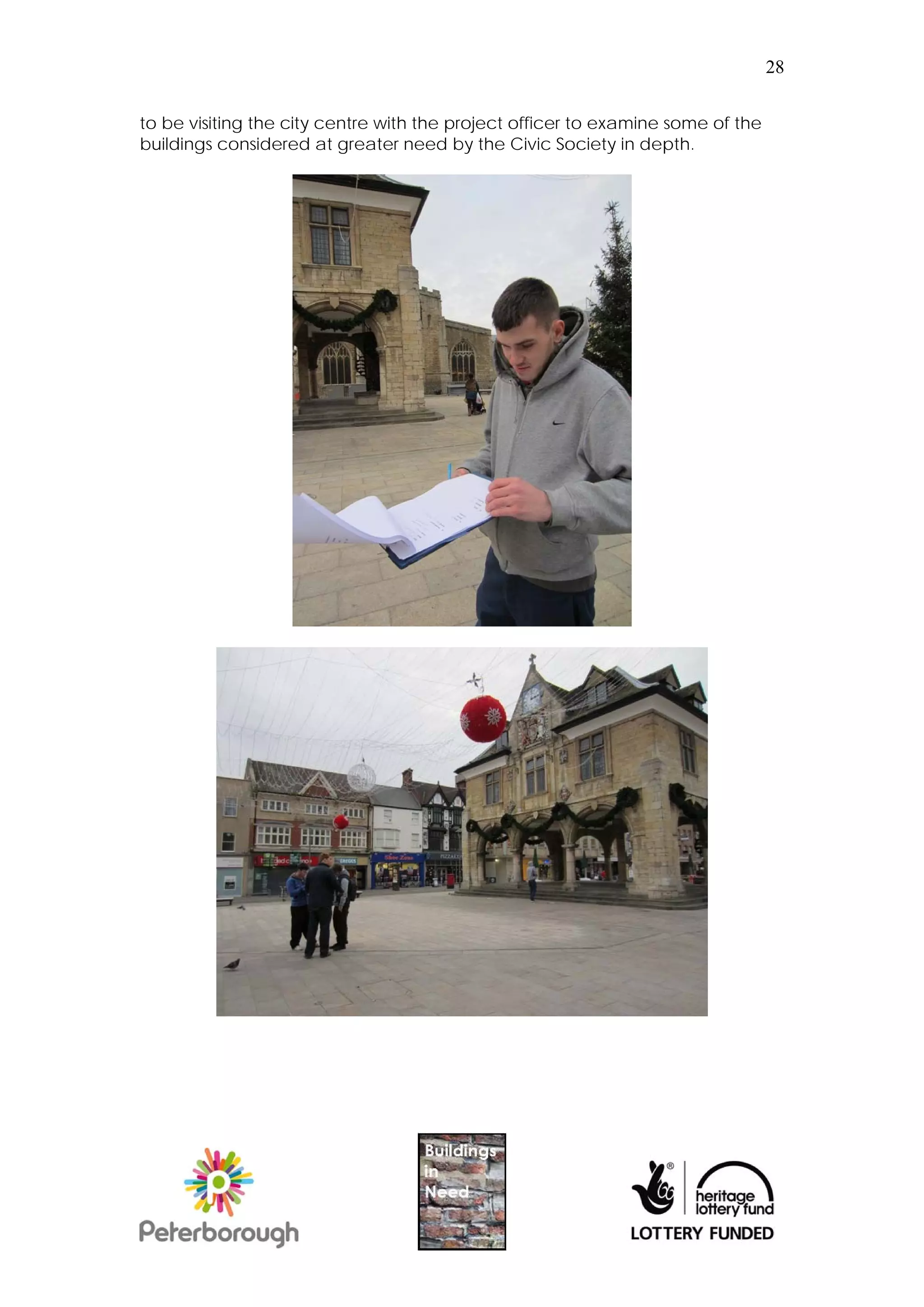

28

to be visiting the city centre with the project officer to examine some of the
buildings considered at greater need by the Civic Society in depth.
29

Total buildings surveyed is 247 (239 different buildings)
Number of volunteers: 40
Total amount of volunteer time for surveys and project support (excluding
time training in Masterclasses): 44 days.
Taking into account the differing skill levels required each day this works out
as a contribution of £4900 to the project.

A toolkit of the results has been created and circulated. This will remain on the
project website following the end of the project.

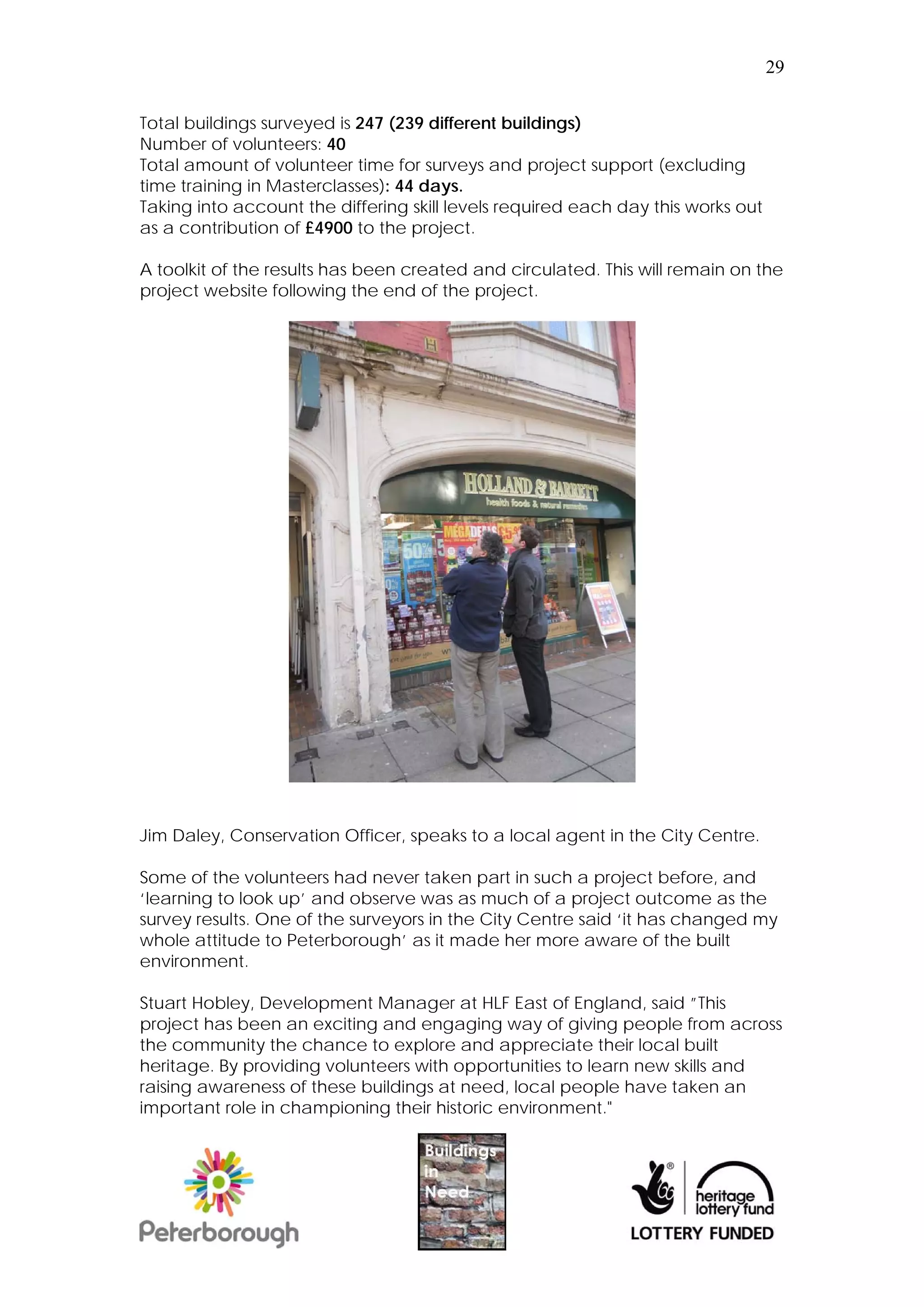

Jim Daley, Conservation Officer, speaks to a local agent in the City Centre.

Some of the volunteers had never taken part in such a project before, and
‘learning to look up’ and observe was as much of a project outcome as the
survey results. One of the surveyors in the City Centre said ‘it has changed my
whole attitude to Peterborough’ as it made her more aware of the built
environment.

Stuart Hobley, Development Manager at HLF East of England, said ”This
project has been an exciting and engaging way of giving people from across
the community the chance to explore and appreciate their local built
heritage. By providing volunteers with opportunities to learn new skills and
raising awareness of these buildings at need, local people have taken an
important role in championing their historic environment."
30

Some of the buildings have been surveyed more than once, with the college
students comparing earlier results to their own. Once completed the forms
were added to an online map and discussed with the Steering Group for the
project, including the Conservation Officer.

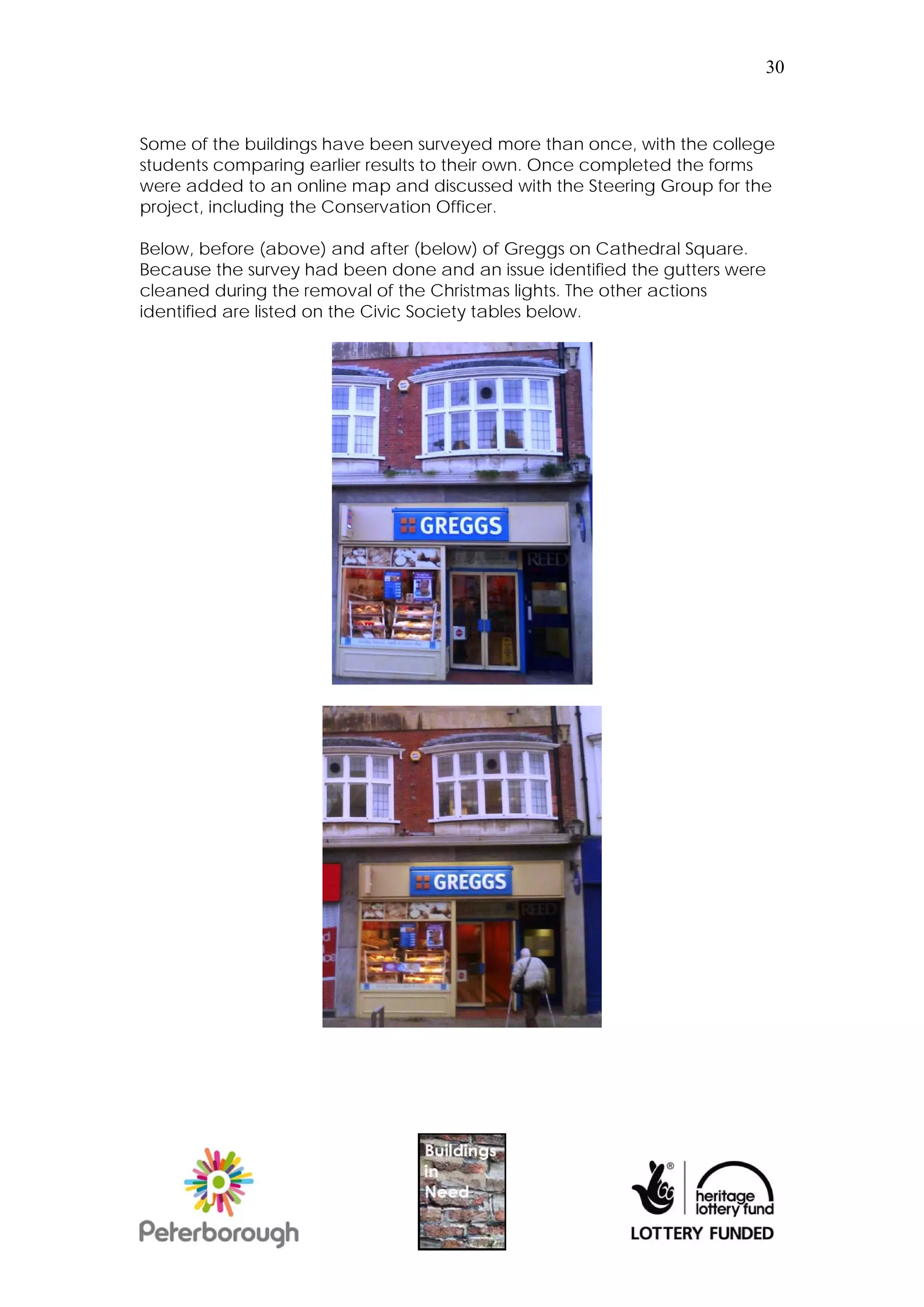

Below, before (above) and after (below) of Greggs on Cathedral Square.
Because the survey had been done and an issue identified the gutters were
cleaned during the removal of the Christmas lights. The other actions
identified are listed on the Civic Society tables below.
31

Civic Society City Centre Survey Results

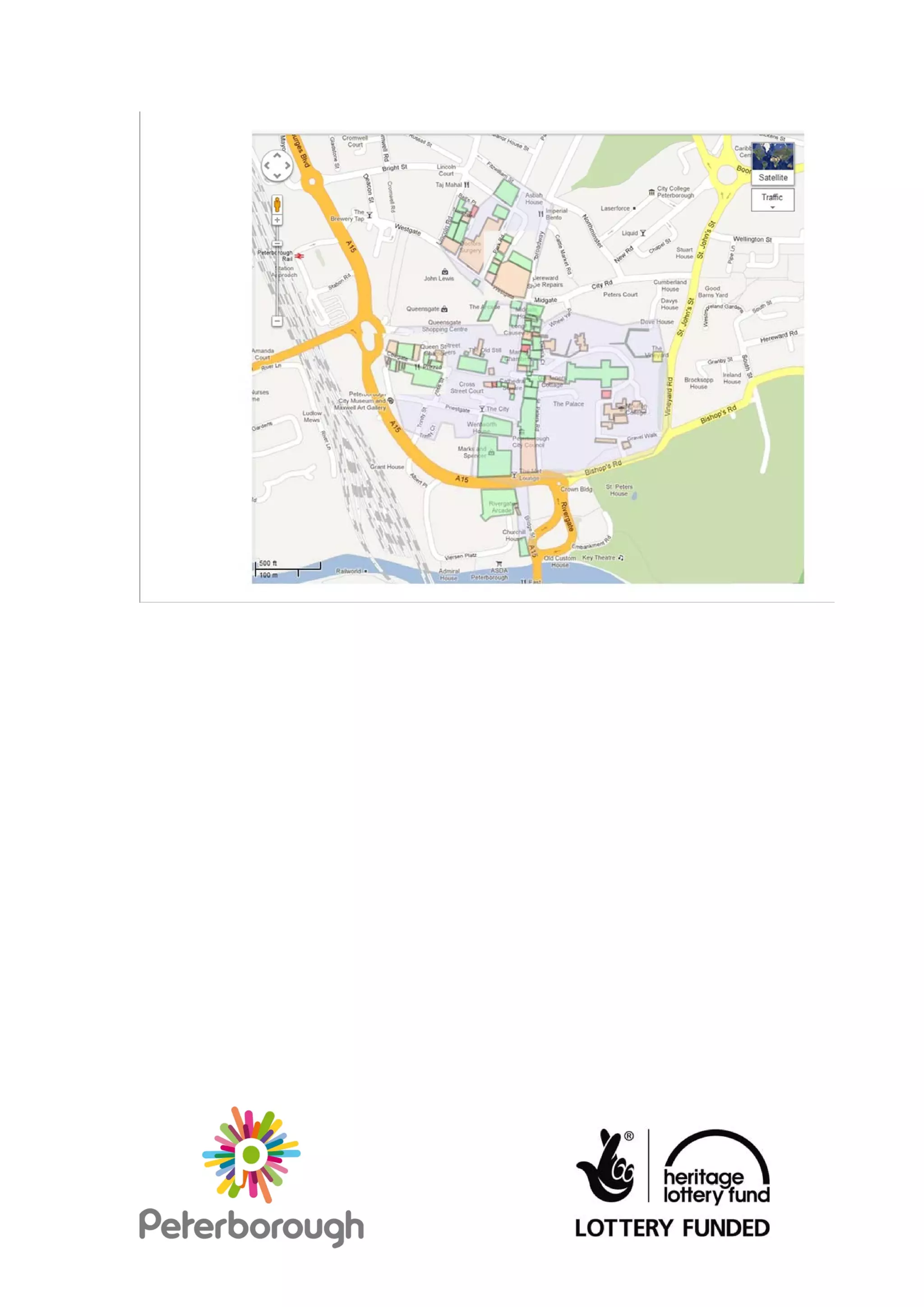

                        Map of survey area showing results

Results
Total city centre surveys:                 133
Total buildings surveyed                   168
‘In Need’ or ‘On way to in Need’           90 properties (54%)
Currently fine                             78 properties. (46%)

‘In Need’

High Priority Properties (listed)          Action
Poor/ Bad                                  8 surveys (11 properties)
Priestgate opposite Museum                 Pre application advice given to
                                           developers
50 Cowgate                                 (target PSICA phase 3)
Laurel Court                               EH already aware
32 -33 Long Causeway                       (all issues seem to stem from some
                                           blocked gutters!) to get a letter from
                                           JD also.

Lower priority (non listed)                Action
North St                                   Letter sent (x2) contact with tenants
Met Lounge and Sketchley (Bridge           To be reviewed
32

St),
Back entrance to JJB sports through
wheel yard
6/6a Cathedral Square                      NB we arranged to clean gutters
                                           whilst removing Christmas
                                           decorations

On way to ‘In Need’’

Need                                    Number
Fair/ in some need                      51 Surveys (69 properties)
Fair/ Good                              10 surveys (10 properties)
Action: used as monitoring baseline, some listed properties picked out:
Minster Precincts properties have been highlighted to Cathedral.

Listed buildings outside of the precincts total 13 properties, all Grade II and
predominantly on Cowgate, Priestgate or Westgate. Exception is the
Grapevine pub which is II*. Several local list buildings are on the list as well.

Currently Fine

Need                                       Number
Good condition                             63 surveys (78 properties)

Action; celebration of good maintenance nearer the time.
33

David Turnock Architects: Summary Report For Buildings in Need

BUILDINGS IN NEED SUMMARY REPORT

Over the period from October 2011 until February 2012 volunteers from
Peterborough Civic Society, Peterborough Regional College and University
Centre Peterborough undertook visual surveys of the external fabric of a total
of 239 buildings in Peterborough City Centre and the Park Conservation Area.
Of this total 168 were within the City Centre Conservation Area, including The
Cathedral Precincts, and 71 are located in the Park Conservation Area.
Buildings inspected included those on the Statutory List of Listed Buildings.

The spreadsheets within this report identify the condition of the external fabric
of each building and include a summary designation of the state of general
repair at the time of the survey. These are broken down into the following
categories:

       Good/Fine condition
       Fair/Good
       Fair
       Poor

This broad categorisation serves to provide a picture of the current state of
these 239 buildings, the summary for each area being as follows:

City Centre/Cathedral Precincts:

Poor                        11 Properties               6.5%
Fair                        69 Properties               41%
Fair/Good                   10 Properties               6%
Good                        78 Properties               46.5%
Total                       168                         100%

Park Conservation Area:

34

Poor                         10 Properties                15%
Fair                         30 Properties                42%
Fair/Good                    1 Property                   1%
Good                         30 Properties                42%
Total                        71 Properties                100%

City Centre Conservation Area

If we look firstly at the City Centre area the analysis of these results gives these
main observations:

   1. There are a relatively small number of buildings currently regarded as
      poor but these, by the very nature of the issues identified in the survey,
      are likely to deteriorate at a faster rate. Where water ingress or
      structural faults are present then the consequent damage to the fabric
      of the building will take longer to repair and will cost more to remedy..

   2. The number of properties described as “Fair” forms 41% of the total.
      These are the buildings on the way to being “in need” and form the
      body of those properties where a regime of regular maintenance by
      owners would avoid their condition worsening in future.

   3. “Fair/Good” and “Good” form the majority of the stock surveyed.
      Generally it is 1 or 2 items on each building where action is required in
      order to maintain them in the current category or improve a greater
      number to be designated as “good”. The conclusion is that regular
      maintenance of minor problems on these buildings is the best way to
      ensure that they are at least maintained in their current state and do
      not deteriorate any further.

   4. In some areas it is the rear of buildings that gives greater cause for
      concern that the front elevations and this is very much the case for
      Wheel Yard which leads into the Cathedral Precincts. This road is used
      as the service access to shops fronting Long Causeway and given its
      nature as a service road, there seems to be little care given to
      elevation of these buildings. There are occurrences of boundary walls
      deteriorating, graffiti on doors and seemingly little maintenance given
      to the building fabric itself. Even where a rear elevation of a building
      has been designed with some degree of thought such as the rear of
      the Sports Direct Shop, there is little consideration given to storage of
      bins and waste which makes the elevation unattractive.

Park Conservation Area

With respect to the properties within the Park Conservation Area the majority
of those surveyed are either Victorian houses converted to commercial use
35

(lower Broadway and Park Road areas) or private houses. The main
exception to this is the Kings School on Park Road where the designation is
generally good. It is generally those commercial premises which are either
unoccupied or only occupied at ground floor where deterioration is occurring
at roof or first floor level. Of the ten properties identified as “poor” the
common items across all buildings is some missing brickwork/stonework to
walls, plant growth in rainwater goods and decoration to the original timber
windows. Buildings such as the Kings School (which is in continuing
occupation and where a programme of refurbishment works is ongoing) are
of a lesser immediate concern.

General outcomes and recommendations

   a) Building owners who are keeping their properties in a good state of
      repair should be contacted and praised accordingly and encouraged
      to maintain a regular maintenance regime in the future.

   b) Where buildings are categorised as being in a “Poor” state action
      needs to be taken in bringing this to the attention of the building
      owner. (This has already been done with respect to properties that
      have visible defects that need remedying in the immediate future to
      avoid future deterioration e.g. missing roof slates).

   c) Encourage members of the public to notice the upper levels of
      buildings within the Conservation Areas. If people can be encouraged
      to look at the City Centre and Park Conservation Area buildings as
      they are as a shared heritage then there is a greater likelihood that
      essential repairs required to a building will be spotted sooner. There is
      also the opportunity to “name and shame” those owners who do not
      keep the fabric of their buildings in good repair.

   d) Identify those building details/ features which can be targeted for
      improvement e.g. inappropriate or poorly detailed shopfronts and
      fascias where a replacement or repair might not cost a great deal to
      carry out but the overall effect on the character of the Conservation
      Area would be hugely beneficial. A current example of this might be
      the Leeds Building Society fascia located in Queen Street Chambers
      which now stands out since the demolition of the building on the Corn
      Exchange site adjacent.

   e) Realise the impact of a poorly maintained building on its neighbours; a
      building that is allowed to deteriorate can “drag down” the visual
      quality of a street.

About David Turnock Architects

David Turnock formed the company in 2001 to serve clients in Peterborough
and the surrounding Cambridgeshire area, having previously been a Director
36

at Ruddle Wilkinson Architects. David succeeded in developing his Client
base and moved into new offices designed by the Company at Lynch Wood
in 2004.

The Company has since grown to a total of 12 staff with two Associates to
assist David with the day to day management and now offers a fully
independent design consultancy to deliver a high quality, creative and
professional, service in both architecture and interior design. A key current
interest is in low energy buildings where schemes are being designed to either
Very Good or Excellent standard.

Staff knowledge base is split approximately 50/50 between Architects and
Building Technologists. We feel that this gives us a good balance between
design and construction detailing for our projects where design proposals
follow good and efficient detailing practice. Our current projects generally
range from £250,000 to £10m in value.

With respect to the skills and experience of staff members, this is extremely
varied including everything from airports, hospitals, railway installations and
large retail environments to residential, student accommodation, medical
and laboratory developments, historic buildings and churches.

Our approach as a Practice is to provide a very thorough service to our
Clients throughout the British Isles and beyond.
37

5) Promotion and Celebration

Outcomes
    Promote the project and engage with interested local groups at a
     minimum of six meetings/events e.g. amenity society meetings,
     Heritage Open Days etc
    Celebrate the project's achievements with a launch event for the
     public, including walking tours led by volunteers, hands on workshops
     and the publication of the survey results.

Update

This project has been promoted at the following 6 events (as well as many
more!). This promotion has allowed information on the project to reach a
wide audience of over 1100 people.

Promotion of project
at six events e.g.
Heritage Open Day,
Civic Soc
                                                                   September 10 and
Event 1                Heritage Open Days                          11
Event 2                Civic Society Meeting                       5th September
                       Environment Network Meeting and Allotment
Event 3                Workshop                                    Sept 22nd
Event 4                Heritage Attractions Group Meeting                        Sep-13
Event 5                Local History Forum                                       Sep-19
Event 6                University Centre Peterborough Induction                  Sep-15
38

Due to
insurance issues
it has not been
possible to have
volunteer
walking tours on
the night, but a
volunteer who is
also a guide for
the city will be
paid to do this
aspect of the
project.
39

Below, a selection of the flyers and posters used to promote the project.

The final event took place on June 28th at 6pm in St John’s Church. This is the
week after the Peterborough Heritage Festival, and on the evening for late
night shopping in the city, and has been decided upon for maximum impact
and visibility.

Press coverage

For this project the project officer and the tutors have been on BBC Radio
Peterborough twice, BBC Radio Cambridgeshire three times and community
Radio Station ‘Radio Peterborough’ once.
40

Antony Mould from the Cambridge Bat Group on Radio Peterborough.

Regular press releases have been sent to the local newspaper (Peterborough
Evening Telegraph), and eleven small articles and one larger article about
the project have been published. Local free magazine Scene has been
supportive.

Promotion has been done through PECT’s Greeniversity, RSA Citizen Power’s
online ‘Ning’ space, through the Civic Society, Local History Forum,
Environmental Network and the Destination Centre, as well as the Heritage
Regeneration Officer Bulletin, which reaches over 750 individuals in the area.
Local Libraries, coffee shops, Churches, the Town Hall and other public
buildings have had flyers left in them. Several different flyers have been
produced to target different audiences or for individual events. As well as this
a professional flyer and poster has been produced to cover the whole
project. These have been printed off ‘in house’ and distributed by hand, post
and email.

Online the project workshops have featured on Projectbook, Heritage HUB,
CBA, the Caravan Club website, Greeniversity, RIBA ‘Love Architecture’
page.

Support in Kind.
This project has been lucky to receive support in kind from a number of local
organisations including Railworld, Peterborough Cathedral, Paper Rhino
Design and local experts. This support has totalled over £2000.

Costs
The total Heritage Lottery Fund grant for the project was £24,200.
41
42
43

Contents
03. Introduction

04. How to use the Toolkit

12. Sources of Information

13. Appendix A: Letter for Volunteers

14. Appendix B: Survey Form

15. Appendix C: Excel Spreadsheet of results and
Google Maps

With thanks to English Heritage, Natural England, Peterborough
City Council, Peterborough Civic Society, Peterborough Regional
College, University Centre Peterborough
Front cover images (top) Cowgate, Peterborough, (bottom left) Volunteer in Peterborough, (bottom right) City Centre
Building.
43

Part I: Introduction                        details of which were turned into
                                            online training modules on the project
This toolkit is designed to help create a   website:
baseline of the condition of historic       http://peterboroughbuildingsinneed.wo
buildings in a discrete area in order to    rdpress.com/.
assess and monitor the scale of neglect
with a view to finding a solution, with     Why Peterborough?
the overarching idea that prevention is
                                            Predominantly the built environment
better than cure. This toolkit assists
                                            of central Peterborough is of solidly
with the identification of interlinked
                                            Edwardian and Victorian stock
issues, such as vacancy, and low
                                            however some buildings date back to
maintenance levels, across larger areas
                                            the Medieval period, and the street
as the first step in resolving such
                                            patterns remain unchanged in the
problems.
                                            majority for the last 900 years. The
                                            main project work was undertaken by
                                            groups of volunteers in the City Centre
                                            Conservation Area and its setting with
                                            a small comparison area surveyed in
                                            the adjoining Park Conservation Area.
                                            Peterborough Unitary Authority
                                            contains within it over 1000 listed
                                            buildings, which when surveyed in
                                            2009 contained 9 ‘at risk’ structures as
                                            designated by the Local Authority and
                                            English Heritage, and 1 ‘at risk’
                                            Conservation Area out of 29, the City
                                            Centre.

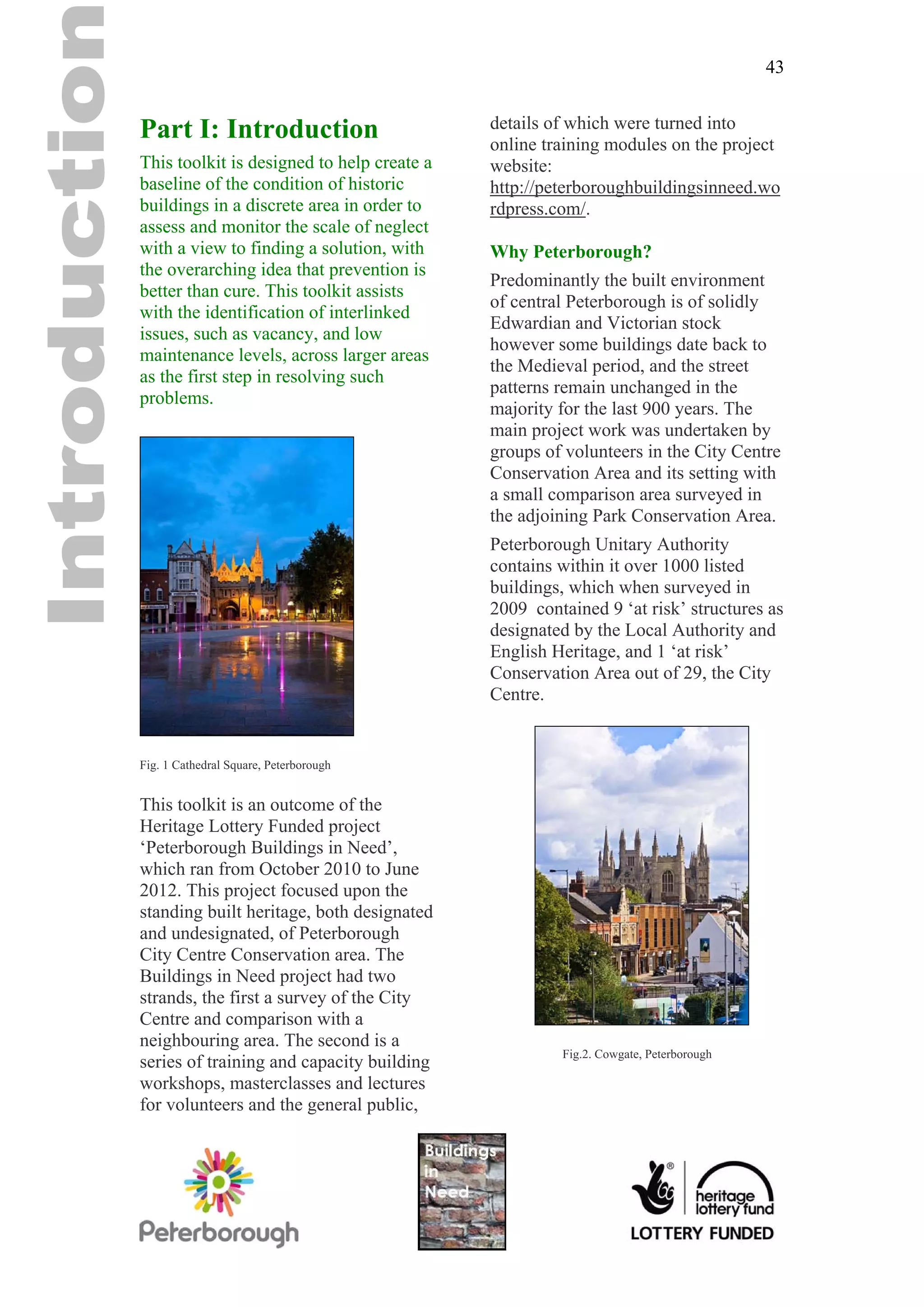

Fig. 1 Cathedral Square, Peterborough

This toolkit is an outcome of the
Heritage Lottery Funded project
‘Peterborough Buildings in Need’,
which ran from October 2010 to June
2012. This project focused upon the
standing built heritage, both designated
and undesignated, of Peterborough
City Centre Conservation area. The
Buildings in Need project had two
strands, the first a survey of the City
Centre and comparison with a
neighbouring area. The second is a

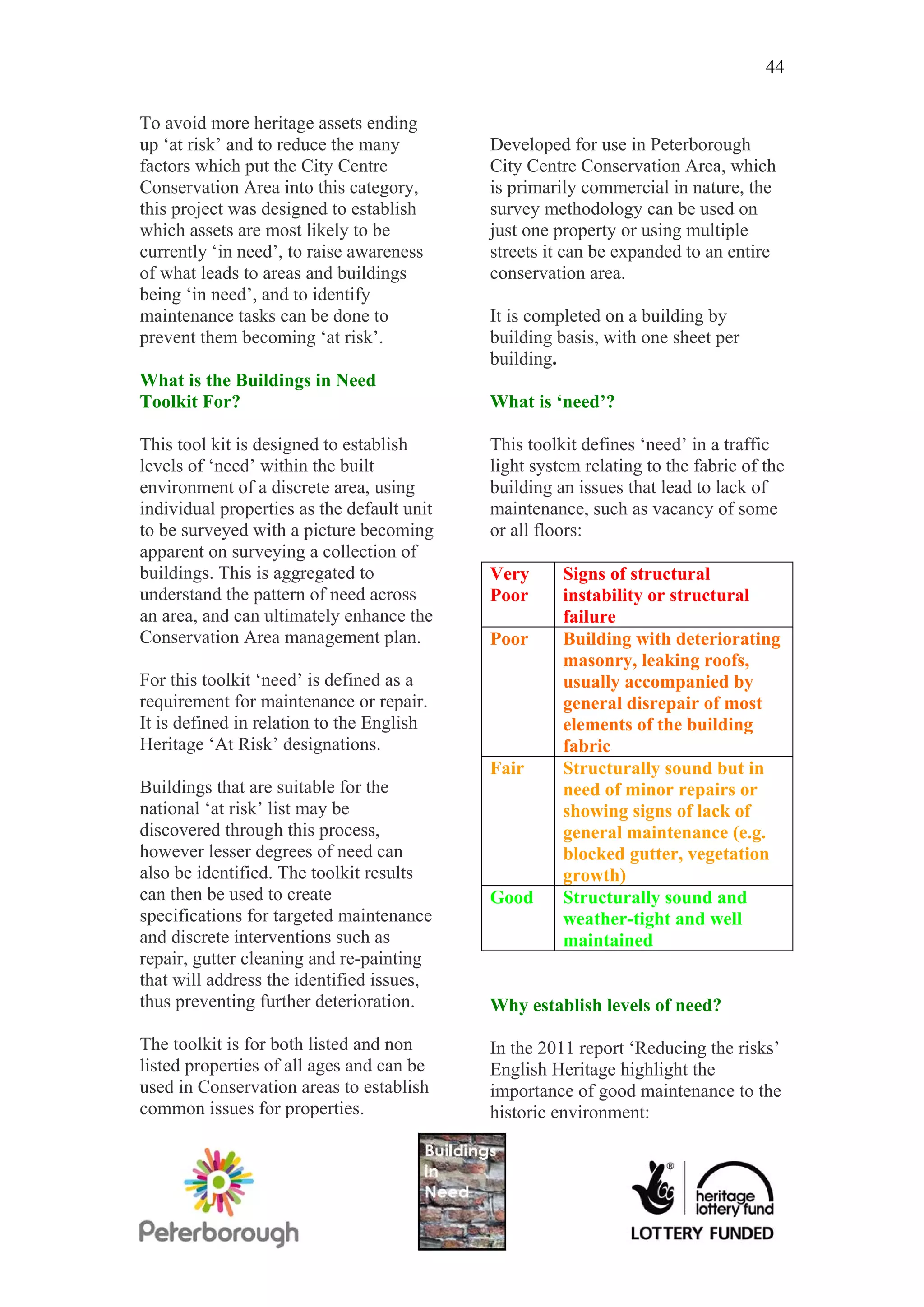

                                                     Fig.2. Cowgate, Peterborough
series of training and capacity building
workshops, masterclasses and lectures
for volunteers and the general public,
44

To avoid more heritage assets ending
up ‘at risk’ and to reduce the many         Developed for use in Peterborough
factors which put the City Centre           City Centre Conservation Area, which
Conservation Area into this category,       is primarily commercial in nature, the
this project was designed to establish      survey methodology can be used on
which assets are most likely to be          just one property or using multiple
currently ‘in need’, to raise awareness     streets it can be expanded to an entire
of what leads to areas and buildings        conservation area.
being ‘in need’, and to identify
maintenance tasks can be done to            It is completed on a building by
prevent them becoming ‘at risk’.            building basis, with one sheet per
                                            building.
What is the Buildings in Need
Toolkit For?                                What is ‘need’?

This tool kit is designed to establish      This toolkit defines ‘need’ in a traffic
levels of ‘need’ within the built           light system relating to the fabric of the
environment of a discrete area, using       building an issues that lead to lack of
individual properties as the default unit   maintenance, such as vacancy of some
to be surveyed with a picture becoming      or all floors:
apparent on surveying a collection of
buildings. This is aggregated to            Very      Signs of structural
understand the pattern of need across       Poor      instability or structural
an area, and can ultimately enhance the               failure
Conservation Area management plan.          Poor      Building with deteriorating
                                                      masonry, leaking roofs,
For this toolkit ‘need’ is defined as a               usually accompanied by
requirement for maintenance or repair.                general disrepair of most
It is defined in relation to the English              elements of the building
Heritage ‘At Risk’ designations.                      fabric
                                            Fair      Structurally sound but in
Buildings that are suitable for the                   need of minor repairs or
national ‘at risk’ list may be                        showing signs of lack of
discovered through this process,                      general maintenance (e.g.
however lesser degrees of need can                    blocked gutter, vegetation
also be identified. The toolkit results               growth)
can then be used to create                  Good      Structurally sound and
specifications for targeted maintenance               weather-tight and well
and discrete interventions such as                    maintained
repair, gutter cleaning and re-painting
that will address the identified issues,
thus preventing further deterioration.      Why establish levels of need?

The toolkit is for both listed and non      In the 2011 report ‘Reducing the risks’
listed properties of all ages and can be    English Heritage highlight the
used in Conservation areas to establish     importance of good maintenance to the
common issues for properties.               historic environment:
45

           ‘Maintenance of heritage assets   A survey such as Buildings in Need
           is essential if they are not to   could be used to highlight areas where
           become at risk, and to prevent    changed policy, strategy or investment
           those that are already at risk    could benefit the built environment.
           from decaying further and         The baseline could form part of a
           thereby escalating the cost of    funding application as part of the
           their repair and consolidation.   ‘evidence of need’ or consultation if
           Buildings, for instance, decay    completed by a community group.
           rapidly when left empty.’

Buildings in a degree of degradation         Who is the Buildings in Need Toolkit
affect their setting, both aesthetically,    for?
economically and also socially. This
ties into research done by Kelling and       This toolkit provides a standard
Wilson in 1982 which resulted in ‘The        process for establishing low level risk
broken windows theory’ which is a            or ‘need’ in an area. It can be used by:
criminological theory of the signalling
effect of urban disorder and vandalism           o Private owners and tenants,
on additional crime and anti-social                residential and business
behaviour. The theory states that                  occupiers
monitoring and maintaining urban                 o Public amenity groups, Civic
environments in a well-ordered                     Societies, interest groups
condition may stop further vandalism             o Students
and escalation into more serious crime.          o Local Planning Authorities
This has been used effectively in New
York amongst other places. A well
presented urban environment is also a
catalyst for business investment in an
area.

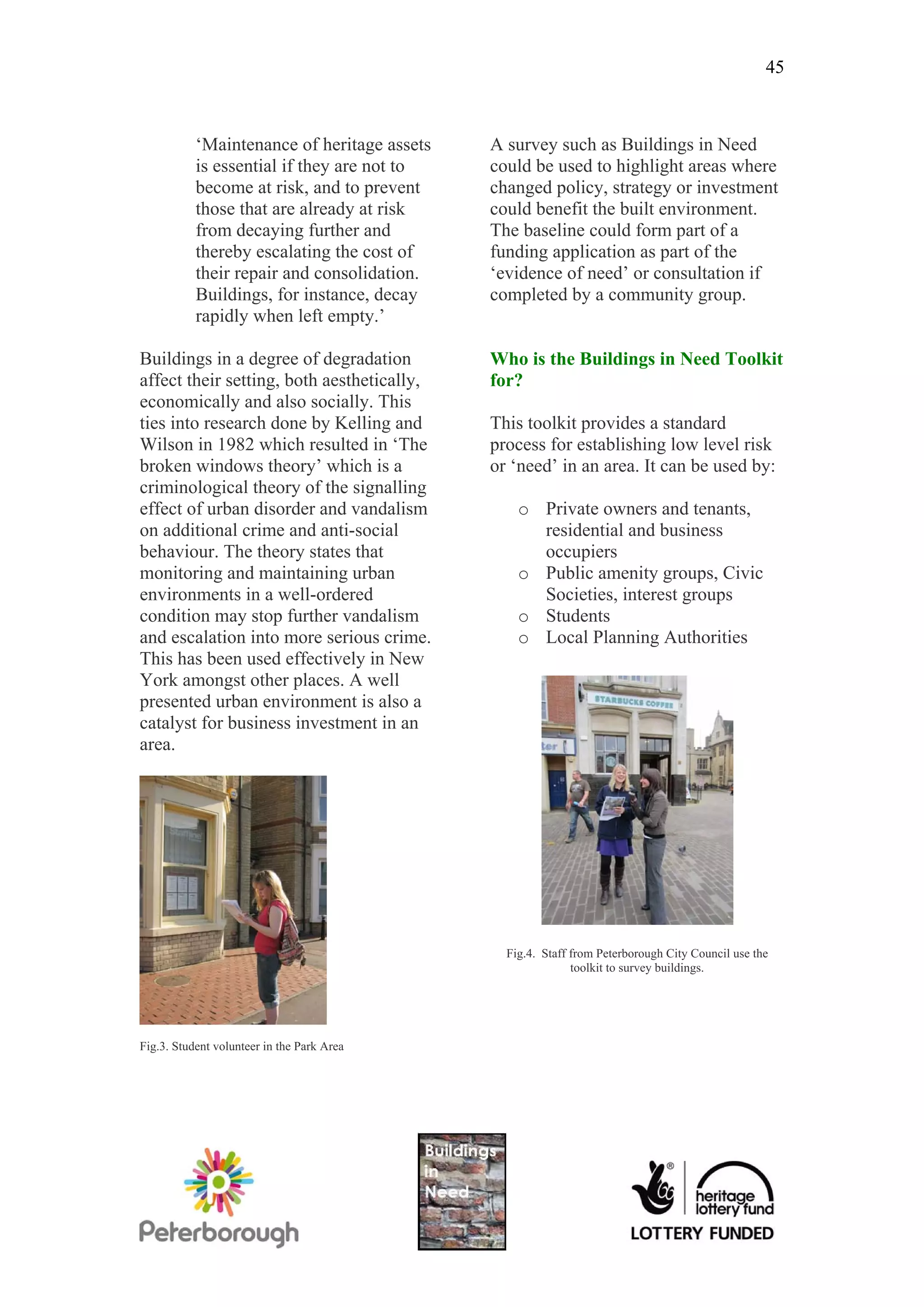

                                               Fig.4. Staff from Peterborough City Council use the
                                                            toolkit to survey buildings.

Fig.3. Student volunteer in the Park Area
46

Part II: How to Use the                     answer in every section but do try to if
                                            possible. Use your judgement for this.
Toolkit
                                            You will need to enter the 1) date of
Before you start                            the survey and 2) your name and
                                            contact details.
Speak to your local Conservation
Officer about a project of this nature if   Name and/ or number of Building
it covers a larger area than one
property. In Peterborough we supplied
                                            This should be evident from the
the volunteers with a letter on headed
                                            building itself. If it is not obvious,
Council paper that explained what the
                                            write the shop name or the last known
project was (see Appendix A).
                                            shop name here.
Equipment
                                            Is it listed?
      Clipboard
      Survey Forms (see Appendix           At Peterborough use was made of
       B)                                   Peterborough Hawkeye online map for
      Map                                  volunteers to identify listed buildings
      Pencil                               within the survey area. However, each
                                            local planning authority will operate its
      High Visibility Vest
                                            own GIS system for recording listed
      Camera
                                            buildings in a map format. If the local
      Binoculars (for looking at roof      planning authority cannot provide
       and chimneys etc)                    access to their GIS system, then the
                                            English Heritage Listed Buildings On-
The survey is completed on a building       line database should be used. Found
by building basis and you will need a       online here: http://list.english-
separate form for each property.            heritage.org.uk/ the list has a ‘Quick
Appendix B to this document includes        Search’ function that should enable the
examples of the forms used at               listing to be determined if the full
Peterborough. Electronic versions can       name or part of the name of the
be downloaded from the Peterborough         property is known. If the location is
Buildings in Need project website and       known but the property name is not the
modified as for use elsewhere.              ‘map search’ feature allows an area
http://peterboroughbuildingsinneed.wo       based search.
rdpress.com/

Completing the forms

The forms are designed to be
completed whilst onsite so include
several tick boxes, with some areas for
building specific comments as
necessary. You do not need to put an
47

                                             wish to suggest which of these three
                                             categories an unlisted building might
Listed buildings make up about 2% of         be placed.
all buildings in England. There are
three grades of listing:

Grade I      A building of exceptional
             interest, only about 2.5%
             of all listed buildings are
             Grade I

Grade II*    Very important and of
             more than special interest,
             approximately 5.5% of
             listed buildings are of
             Grade II*

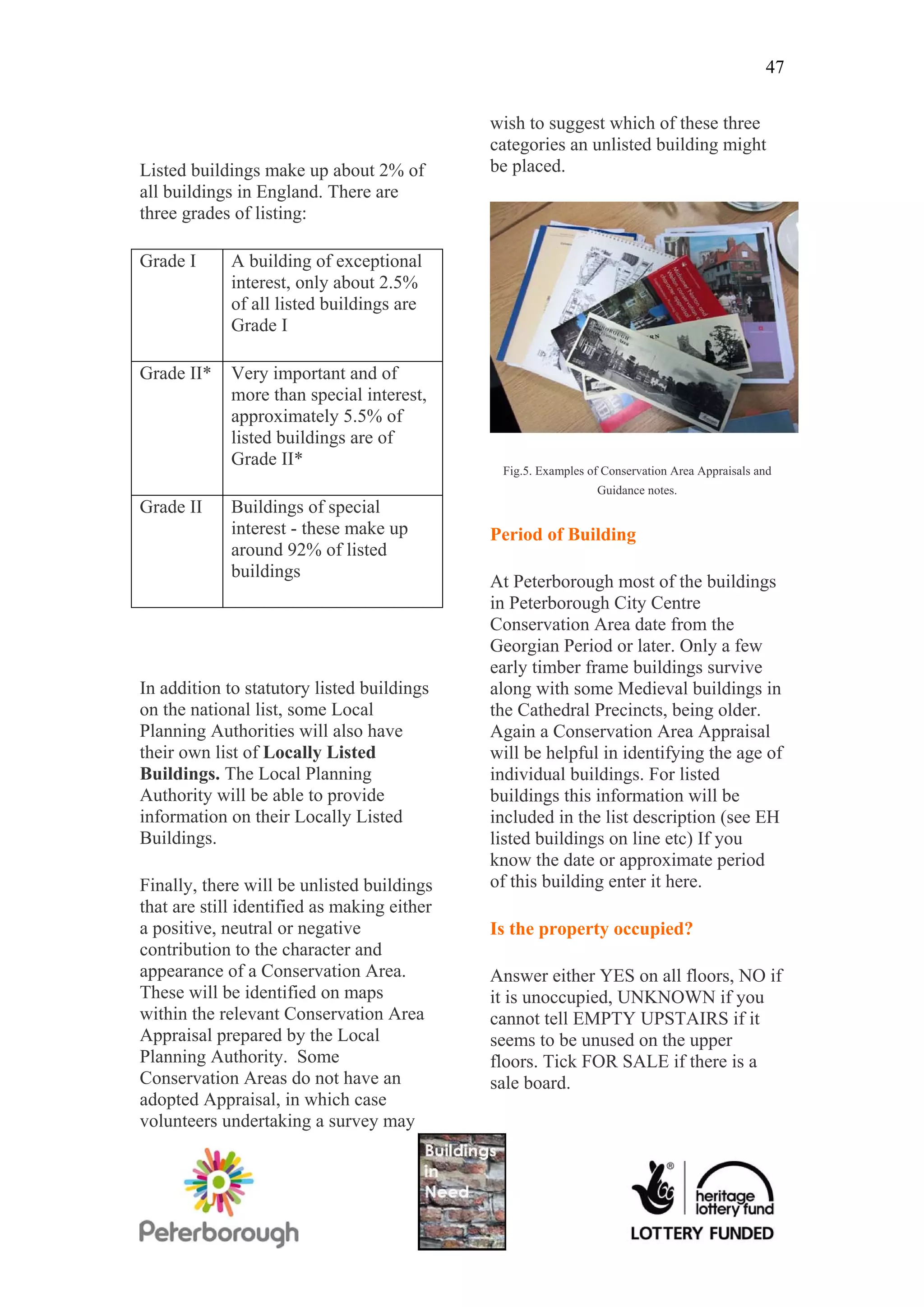

                                              Fig.5. Examples of Conservation Area Appraisals and
                                                               Guidance notes.
Grade II     Buildings of special
             interest - these make up        Period of Building
             around 92% of listed
             buildings
                                             At Peterborough most of the buildings
                                             in Peterborough City Centre
                                             Conservation Area date from the
                                             Georgian Period or later. Only a few
                                             early timber frame buildings survive
In addition to statutory listed buildings    along with some Medieval buildings in
on the national list, some Local             the Cathedral Precincts, being older.
Planning Authorities will also have          Again a Conservation Area Appraisal
their own list of Locally Listed             will be helpful in identifying the age of
Buildings. The Local Planning                individual buildings. For listed
Authority will be able to provide            buildings this information will be
information on their Locally Listed          included in the list description (see EH
Buildings.                                   listed buildings on line etc) If you
                                             know the date or approximate period
Finally, there will be unlisted buildings    of this building enter it here.
that are still identified as making either
a positive, neutral or negative              Is the property occupied?
contribution to the character and
appearance of a Conservation Area.           Answer either YES on all floors, NO if
These will be identified on maps             it is unoccupied, UNKNOWN if you
within the relevant Conservation Area        cannot tell EMPTY UPSTAIRS if it
Appraisal prepared by the Local              seems to be unused on the upper
Planning Authority. Some                     floors. Tick FOR SALE if there is a
Conservation Areas do not have an            sale board.
adopted Appraisal, in which case
volunteers undertaking a survey may
48

Current Use

Is it a shop, cafe, estate agents? Please
fill in the main use and function of the
building here.

                                                           Fig.8. The Draper’s Arms, Peterborough

                                                           Is there any evidence it was used as
                                                           something else? For example at
                                                           Peterborough the Drapers Arms was
                                                           once a Drapers shop. If you do not
                                                           know leave this answer blank.

Fig.6 and Fig.7 Shop fascias in Peterborough City Centre
photographed by Buildings in Need Volunteer

Evidence of previous use?

                                                           Windows

                                                           Do they look sound? Are they
                                                           boarded? There may be unpainted
                                                           frames and signs of decaying or rotting
49

woodwork, or signs of cracking to the                     roof1? Is the roof line straight or
glass. Do they look original or are                       bowing? Note this in the other section
they modern replacements?                                 if this is the case. Also what are the
                                                          condition of the chimneys (if visible).
                                                          Tall chimneys will often bow towards
                                                          the south (due to salts being deposited
                                                          in the bed joints on the north side,
                                                          while the sun and wind dry out the
                                                          south side)

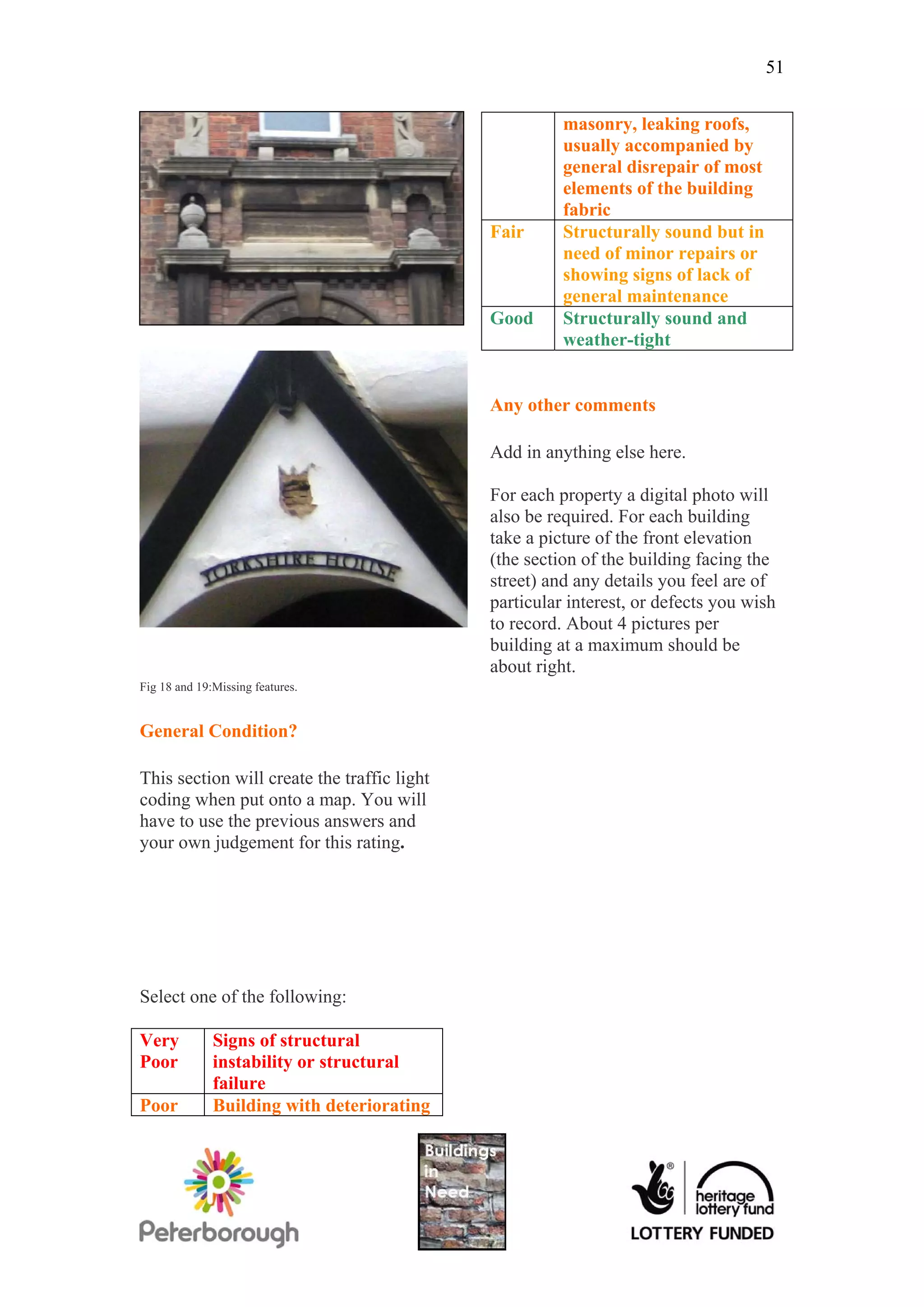

                                                              Fig 12, 13 and 14: A hole in a roof, bowing
                                                              roofline and bituminous covering on a roof,
                                                                     potentially disguising issues.

                                                          What kind of condition are
                                                          the walls visible from the
                                                          public footpath in?

                                                          There may be evidence of damage
                                                          through spalling stonework/ bricks,
                                                          missing mortar, inappropriate repairs,
                                                          cracks of all sizes, bowing or bulging
                                                          in the wall (eye along the line of the
 Fig 9. 10 and 11: Protected and boarded windows, and a   wall), damp, staining, defective render,
        smashed one in Peterborough City Centre.

                                                          1
                                                           The English Heritage Guidance note on thatch
                                                          contains the following sentence ‘Bear in mind that the
Roof Condition                                            performance of thatch is not linked intimately to its
                                                          appearance, and like a much-repaired wall a roof can
                                                          present a motley appearance without being inferior to
                                                          a much neater looking new job’. (English Heritage,
Are there missing slates or tiles? Is                     Thatch and Thatching, 2000. Available online here:
there evidence of decay in a thatched                     http://www.english-
                                                          heritage.org.uk/content/publications/docs/thatchandth
                                                          atching.pdf )
50

rot in exposed timber framing or
vandalism

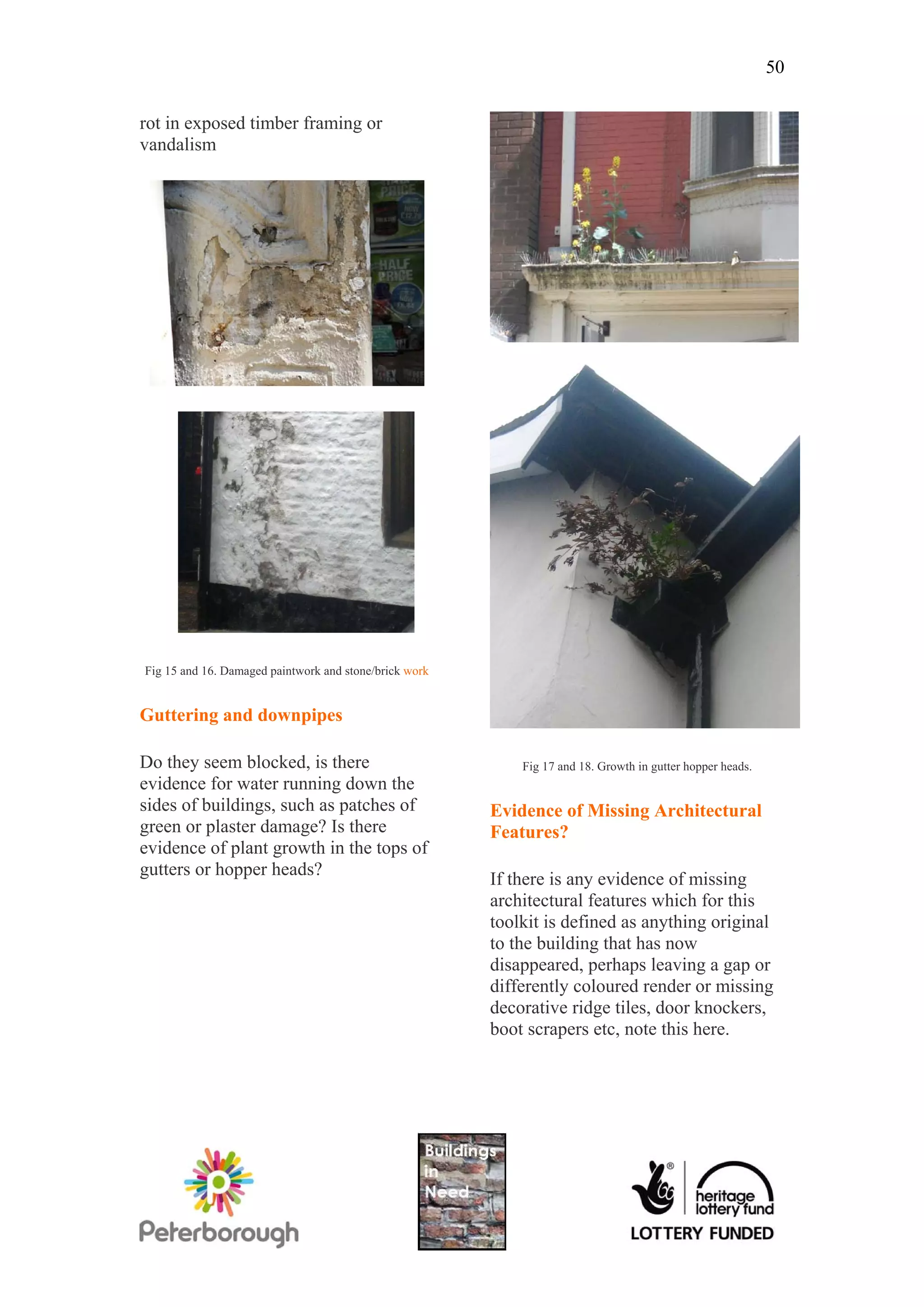

Fig 15 and 16. Damaged paintwork and stone/brick work

Guttering and downpipes

Do they seem blocked, is there                              Fig 17 and 18. Growth in gutter hopper heads.
evidence for water running down the
sides of buildings, such as patches of                  Evidence of Missing Architectural
green or plaster damage? Is there                       Features?
evidence of plant growth in the tops of
gutters or hopper heads?
                                                        If there is any evidence of missing
                                                        architectural features which for this
                                                        toolkit is defined as anything original
                                                        to the building that has now
                                                        disappeared, perhaps leaving a gap or
                                                        differently coloured render or missing
                                                        decorative ridge tiles, door knockers,
                                                        boot scrapers etc, note this here.
51

                                                       masonry, leaking roofs,
                                                       usually accompanied by
                                                       general disrepair of most
                                                       elements of the building
                                                       fabric
                                             Fair      Structurally sound but in
                                                       need of minor repairs or
                                                       showing signs of lack of
                                                       general maintenance
                                             Good      Structurally sound and
                                                       weather-tight

                                             Any other comments

                                             Add in anything else here.

                                             For each property a digital photo will
                                             also be required. For each building
                                             take a picture of the front elevation
                                             (the section of the building facing the
                                             street) and any details you feel are of
                                             particular interest, or defects you wish
                                             to record. About 4 pictures per
                                             building at a maximum should be
                                             about right.
Fig 18 and 19:Missing features.

General Condition?

This section will create the traffic light
coding when put onto a map. You will
have to use the previous answers and
your own judgement for this rating.

Select one of the following:

Very          Signs of structural
Poor          instability or structural
              failure
Poor          Building with deteriorating
52

                                                         Estimate of urgency of works?

                                                         If works seem urgent make a note here,
                                                         this is helpful for absentee landlords to
                                                         have an idea of urgency for the
                                                         maintenance required. The proviso is
                                                         obviously that this is the opinion of
                                                         one person.

                                                         What to do with your results

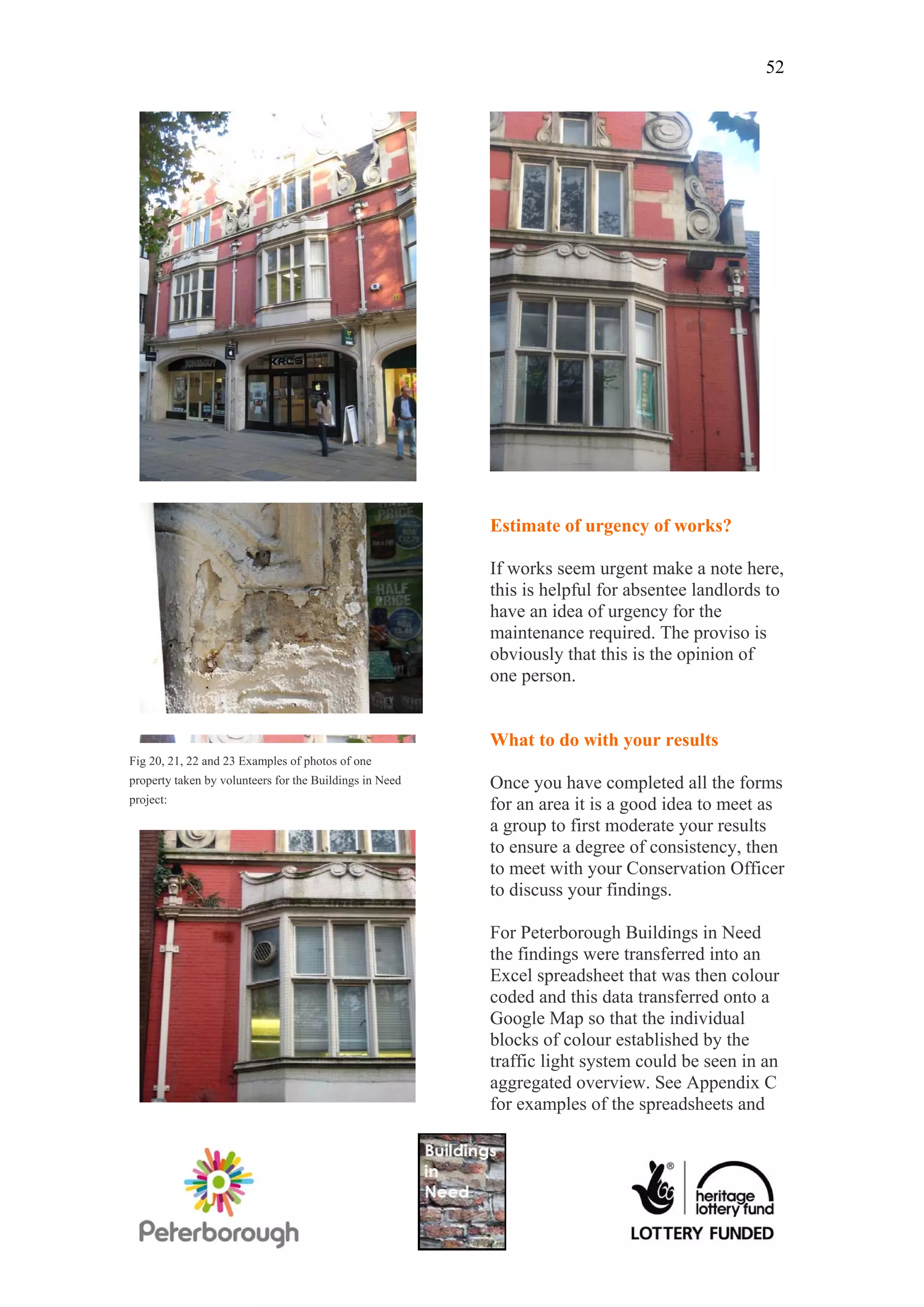

Fig 20, 21, 22 and 23 Examples of photos of one
property taken by volunteers for the Buildings in Need   Once you have completed all the forms
project:
                                                         for an area it is a good idea to meet as
                                                         a group to first moderate your results
                                                         to ensure a degree of consistency, then
                                                         to meet with your Conservation Officer
                                                         to discuss your findings.

                                                         For Peterborough Buildings in Need
                                                         the findings were transferred into an
                                                         Excel spreadsheet that was then colour
                                                         coded and this data transferred onto a
                                                         Google Map so that the individual
                                                         blocks of colour established by the
                                                         traffic light system could be seen in an
                                                         aggregated overview. See Appendix C
                                                         for examples of the spreadsheets and
53

maps and the project website for the            The annual English Heritage register
complete set of outputs                         also includes Conservation Areas at Risk
http://peterboroughbuildingsinneed.wo           and the results of Buildings in Needs
rdpress.com/.                                   survey can help inform a Local Planning
                                                Authority in providing up-to-date
Local authorities have a primary role in        information to English Heritage on the
protecting the historic environment.            state of their conservation areas,
They often have a local heritage at risk        including those which may need to be
register for buildings that are Grade II or     added to the ‘at risk’ register.
Locally Listed and are considered to be
‘at risk’. If you believe you have
identified a building that meets this
criteria, in that in the traffic light system
it is red and is also listed Grade II or
locally listed, then you should raise this
with your local Conservation Officer.

English Heritage publish an annual list
of Heritage at Risk, which includes
Grade I and II* buildings. If you believe
your survey had identified a Grade I or
II* building that needs to be added to the
English Heritage at risk register, then
this should again be raised with the local
Conservation Officer, who will pass it
on to English Heritage for their
consideration to add to the national ‘at
risk’ register.

Getting a building on one of these lists
can be the first step in tackling neglect,
and to assess and monitor the scale of
the problem and prioritise resources and
action. Local authorities can take action
to secure the preservation and
maintenance of historic buildings
through the use of statutory notices.
It is essential that local authorities make
best use of their powers to secure
buildings at risk, to ‘stop the rot’ and
prevent the costs escalating beyond the
point where it is economic to repair. To
assist in the process English Heritage
has recently published updated guidance
(Stopping the Rot) for local planning
authorities on taking action to save
historic buildings.
54

Sources of Information:                       HELM website:
                                              http://www.helm.org.uk/
Peterborough Buildings in Need
project website:
http://peterboroughbuildingsinneed.wo
rdpress.com/

Heritage at Risk: http://www.english-
heritage.org.uk/caring/heritage-at-risk/

Reducing Risk, 2011 available at
http://www.english-
heritage.org.uk/content/publications/do
cs/acc-reducing-risks-2011.pdf

Stopping the Rot guidance to
enforcement actions Local Authorities
can take for historic buildings:
http://www.english-
heritage.org.uk/publications/stoppingth
erot/

SPAB maintenance site:
http://www.maintainyourbuilding.org.
uk/pages/maintenance.html

Stitch in Time Guidance available
online here:
http://www.dlrcoco.ie/conservation/IHBC.pdf
55

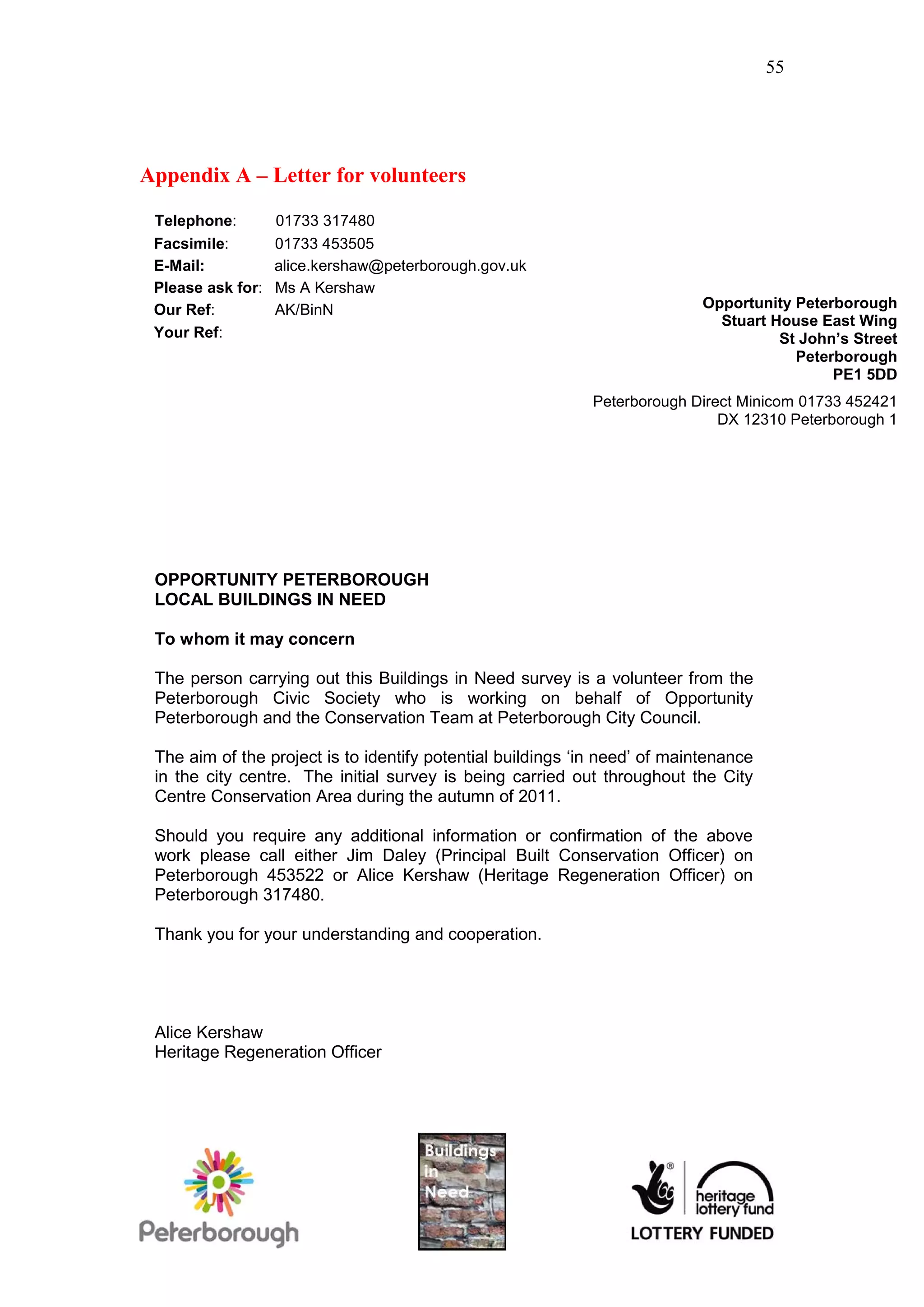

Appendix A – Letter for volunteers

 Telephone:        01733 317480
 Facsimile:        01733 453505
 E-Mail:           alice.kershaw@peterborough.gov.uk
 Please ask for:   Ms A Kershaw
 Our Ref:          AK/BinN                                                  Opportunity Peterborough
                                                                              Stuart House East Wing
 Your Ref:                                                                            St John’s Street
                                                                                        Peterborough
                                                                                             PE1 5DD
                                                             Peterborough Direct Minicom 01733 452421
                                                                              DX 12310 Peterborough 1

 OPPORTUNITY PETERBOROUGH
 LOCAL BUILDINGS IN NEED

 To whom it may concern

 The person carrying out this Buildings in Need survey is a volunteer from the
 Peterborough Civic Society who is working on behalf of Opportunity
 Peterborough and the Conservation Team at Peterborough City Council.

 The aim of the project is to identify potential buildings ‘in need’ of maintenance
 in the city centre. The initial survey is being carried out throughout the City
 Centre Conservation Area during the autumn of 2011.

 Should you require any additional information or confirmation of the above
 work please call either Jim Daley (Principal Built Conservation Officer) on
 Peterborough 453522 or Alice Kershaw (Heritage Regeneration Officer) on
 Peterborough 317480.

 Thank you for your understanding and cooperation.

 Alice Kershaw
 Heritage Regeneration Officer
56

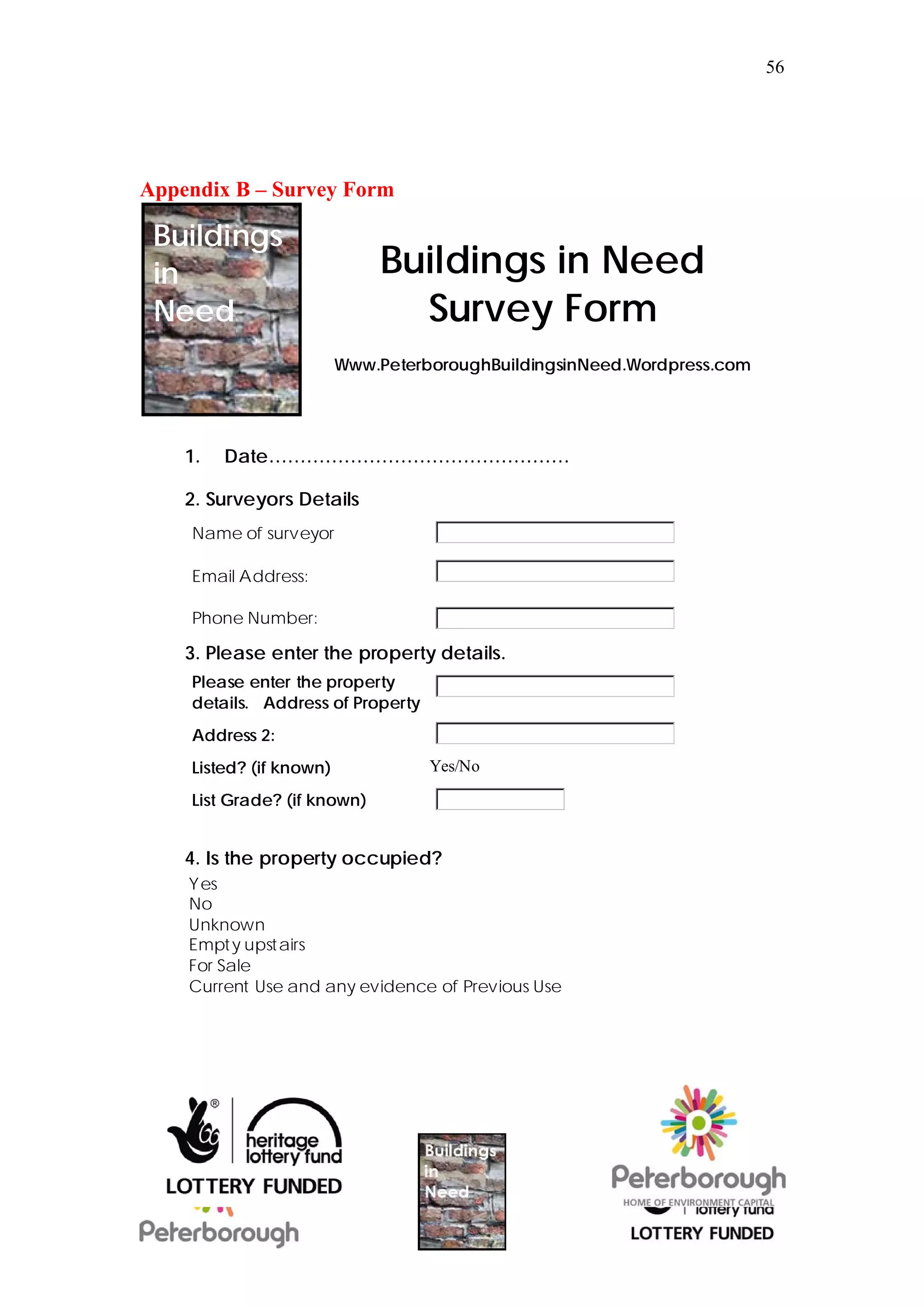

Appendix B – Survey Form

 Buildings
 in                          Buildings in Need
 Need                          Survey Form
                         Www.PeterboroughBuildingsinNeed.Wordpress.com

    1.   Date…………………………………………

    2. Surveyors Details
    Name of surveyor

    Email Address:

    Phone Number:

    3. Please enter the property details.
    Please enter the property
    details. Address of Property
    Address 2:
    Listed? (if known)             Yes/No

    List Grade? (if known)

    4. Is the property occupied?
    Yes
    No
    Unknown
    Empt y upstairs
    For Sale
    Current Use and any evidence of Previous Use
57

5. Condition of windows
Please tick or underline
Good - structurally sound, well maintained and painted
Fair - showing some lack of maintenance, poor decoration
Poor - in need of maintenance
Very bad - broken or boarded, rot

6. Condition of roof if visible
Please tick or underline
Good – well maintained, wind and weather tight
Fair – wind and weather tight, no visible deterioration
Poor – slipped slates
Very Bad – missing slates, holes

Is there evidence of previous repair eg mortar on the roof, different colour patches?
Describe:

Other (please specify)

7. Condition of visible walls? (Front or side walls visible from public footpath)
                           Many               Some            No evidence
Missing stonework/
bricks
Missing mortar
Inappropriate mortar
repairs
Small cracks
Major cracks
Evidence of wall
movement
Damp/ water
staining
Graffiti
Peeling plaster or
render

Other (please specify)
…………………………………………………………………………………………………
…………………………………………………………………………………………………
58

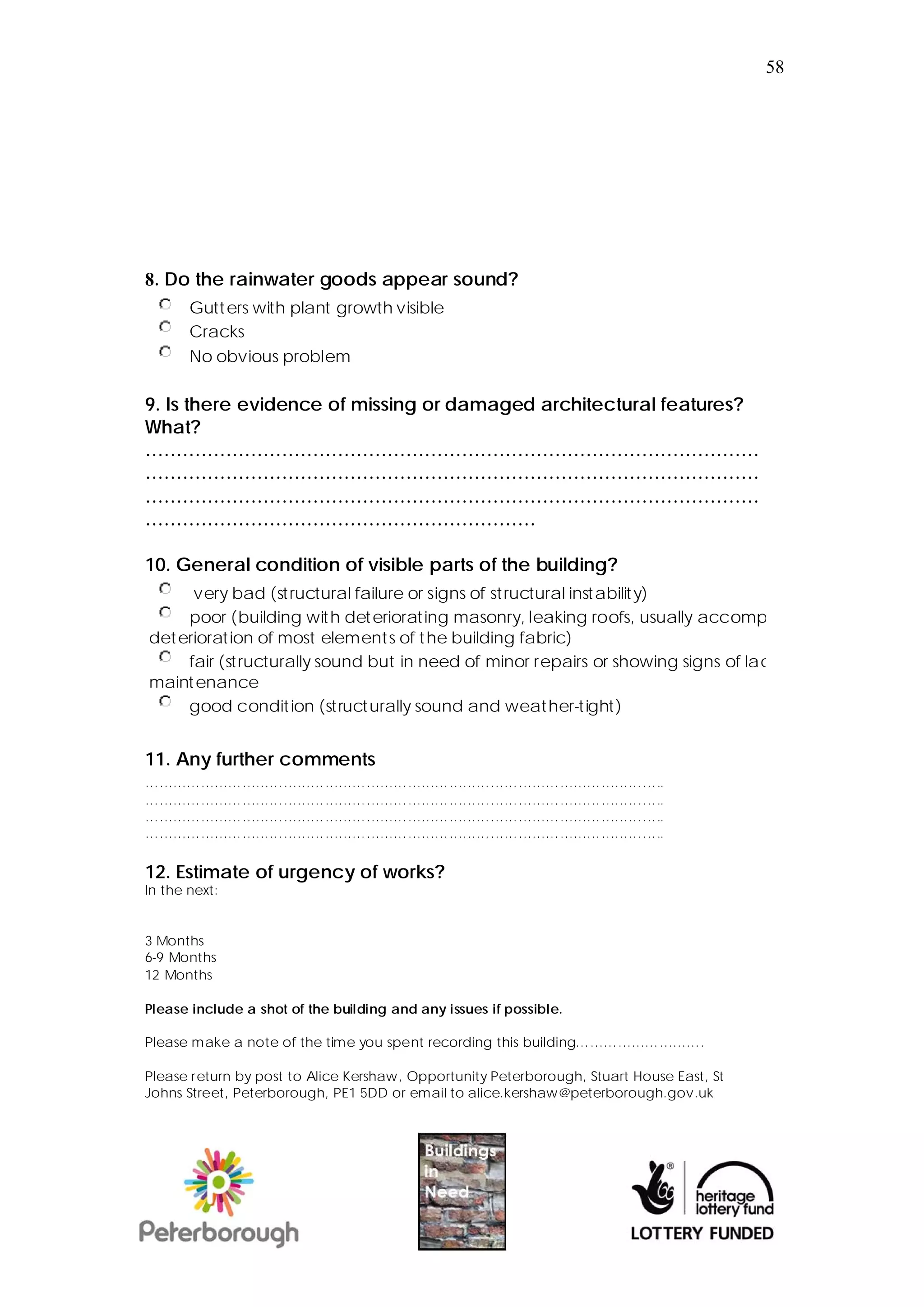

8. Do the rainwater goods appear sound?
       Gutt ers with plant growth visible
       Cracks
       No obvious problem

9. Is there evidence of missing or damaged architectural features?
What?
………………………………………………………………………………………
………………………………………………………………………………………
………………………………………………………………………………………
………………………………………………………

10. General condition of visible parts of the building?
      very bad (st ructural failure or signs of st ructural instabilit y)
     poor (building wit h det eriorat ing masonry, leaking roofs, usually accomp
det erioration of most element s of t he building fabric)
     fair (st ructurally sound but in need of minor repairs or showing signs of lac
maint enance
     good condit ion (st ruct urally sound and weather-tight)

11. Any further comments
…………………………………………………………………………………………………..
…………………………………………………………………………………………………..
…………………………………………………………………………………………………..
…………………………………………………………………………………………………..

12. Estimate of urgency of works?
In the next:

3 Months
6-9 Months
12 Months

Please include a shot of the building and any issues if possible.

Please make a note of the time you spent recording this building……………………….

Please return by post to Alice Kershaw, Opportunity Peterborough, Stuart House East, St
Johns Street, Peterborough, PE1 5DD or email to alice.kershaw@peterborough.gov.uk
59

Notes

There is more information on Buildings in Need at:

www.Pet erboroughBuildingsinNeed.Wordpress.com

Is it listed?

To est ablish if the building is list ed and the grade use Peterborough Hawk-
eye.

http://hawkeye.peterborough.gov.uk/hawkeye/

To use Hawkeye simply zoom t o the location required, if you do not know t he
address, or enter the address in the search box (t op right , between 'layers'
and 'nearest').

Once you have a location in t he central box you can either see it as a St reet
View, Ordnance Survey map, or an aerial view. This would be good to have
as a print out to allow you to find t he propert y on t he ground.

To find out if the building is listed click on 'Built Environment ' on the right hand
side, and check the box for 'Listed Buildings' and 'Conservation Areas'.

Then click 'Display on Map'. This will show you if the property is in t he cit y cen-
tre conservat ion area or not , and if it is red and you hover the cursor over it it
will show you t he name and list ing grade. If the building is not listed it is st ill of
int erest in the cit y cent re, it does not mater for t his survey whether you survey
a listed building or not!

List ed buildings make up about 2% of all buildings in England. There are three
grades of list ing:

Grade I - a building of exceptional int erest , only about 2.5% of all listed build-
ings are Grade I

Grade II* - very important and of more than special int erest, 5.5% of list ed
buildings are of this grade

Grade II - buildings of special interest - t hese make up around 92% of listed
buildings
60

Appendix C: Excel Spreadsheet of results and Google Maps
Alice Kershaw
Heritage Regeneration Officer
Email: alice.kershaw@peterborough.gov.uk
Website: www.opportunitypeterborough.co.uk/heritage

Project website: http://peterboroughbuildingsinneed.wordpress.com/

Buildings in need_update_junebig

  • 1.
    1 Peterborough Buildings in Need September 2011 – June 2012 Heritage Lottery Fund Project Reference: YH-11-00479 Project Update: June 2012 Report Author: Alice Kershaw, Heritage Regeneration Officer, Opportunity Peterborough
  • 2.
  • 3.
    3 Contents This report bookletcomprises of the report on the project outcomes and achievements, including a summary of results verified by a local architect, and the toolkit for doing a Buildings in Need Survey Section Title Page number Executive Summary 5 Overview of Project 5 Project Aims 8 Overview of Project Outcomes 10 1) Online 11 2) Steering Group 13 3) Training for volunteers and the general public 13  Quarry Visit 16  Lectures 20  Masterclasses 22 4) Building Surveys 26  Civic Society City Centre Survey Results 31  Verification and summary of results by David Turnock, Architect 33 5) Promotion and Celebration 37 Press coverage 37 Support in Kind 40 Costs 40 Buildings in Need Toolkit 42 1. Introduction 43 2. How to use the Toolkit 46 3. Sources of Information 54 4. Appendix A: Letter for Volunteers 55 5. Appendix B: Survey Form 56 6. Appendix C: Excel Spreadsheet of results and Google Maps 60
  • 4.
  • 5.
    5 Executive Summary The PeterboroughBuildings in Need project has been running since September 2011, and will finish on June 28th 2012 with a celebration event. Between September and November 2011 over 1100 people have attended a lecture or workshop on the project, in total 12 lectures at St Johns Church and 17 workshops at various historic locations have been run, as well as a series of visits. Three groups of volunteers from the Civic Society, University Centre Peterborough and Peterborough Regional College have surveyed over 250 buildings and given over 40 days of volunteer time to the project. The project has been promoted at over 6 events, with hundreds of flyers, posters and using a variety of social media tools. The project website is up and running, with 40 pages, 10 posts and 5 modules available on it. An embedded map helps share the gathered information. Photos showing aspects of buildings that can put them ‘in need’. From top left, missing architectural features in the Park Area, Graffiti on Broadway (Park Area) and growth in gutters in the City Centre Conservation Area. Overview of Project Peterborough Buildings in Need ran from September 2011 until the end of June 2012, nine months in total. The total Heritage Lottery Fund grant for the project was £24,200. The project officer is Alice Kershaw.
  • 6.
    6 Through understanding andawareness raising of the historic environment of Peterborough's city centre, members of the local community have learnt what puts the historic environment 'in need' of becoming officially 'at risk', the challenges faced by the historic environment and how these can be managed. This training was provided in the form of daytime, evening, half and full day courses for both dedicated volunteers and for the general public, as a way of sharing information and to encourage participation in the project. This project trained users of the space to understand aspects such as 'significance' 'setting' and levels of need. It created the most complete building by building snapshot survey of the degree of 'need' present within the city centre conservation area. This survey was carried out by volunteers from the general public, local groups members and volunteers, who was trained up and supported by the Heritage Regeneration Officer and Built Environment team.
  • 7.
    7 It created anon-line toolkit of resources, including a 'traffic light' style system for flagging levels of need, to enable people to engage on a local level with the management of the built heritage of Peterborough, as a lasting legacy of the project. People were engaged as on the ground heritage champions, aware of the built environment and the vulnerabilities found there.
  • 8.
    8 Project Aims The overallproject aims are as follows:  Raise public awareness of the heritage value of Peterborough with a focus on the City Centre  Promote the good management of heritage assets  Deliver a programme of targeted training, activities and events  Provide support, feedback and development opportunities for volunteers  Provide comprehensive, accessible information on the condition of our heritage
  • 9.
    9 In order toachieve this the following approved purposes of grant were agreed upon:  Create an interactive project website for participants using Wordpress, to allow access to downloadable resources, training modules and survey results  Produce five online modules containing training material and project resources  Establish a community steering group  Deliver four walking tours and at least 12 master classes as part of the training for participants.  Carry out a survey of at least 50 buildings 'in need' in Peterborough by volunteer participants. Validate the results and obtain feedback from professional architects and surveyors.  Deliver a historic environment workshop for at least 20 attendees, plus a lunchtime and an evening lecture series with 350 attendees over ten sessions  Promote the project and engage with interested local groups at a minimum of six meetings/events e.g. amenity society meetings, Heritage Open Days etc  Celebrate the project's achievements with a launch event for the public, including walking tours led by volunteers, hands on workshops and the publication of the survey results.
  • 10.
    10 Overview of ProjectOutcomes The project outcomes split into 5 key interlocking areas, the online presence of the project through a website, the steering group, training for volunteers and the general public (for the purposes of this grant the general public count as volunteers once they have undergone any training, as they have
  • 11.
    11 given up theirtime for the project), building surveys and the promotion and celebration of the project as a whole. 1) Online Outcomes  Create an interactive project website for participants using Wordpress, to allow access to downloadable resources, training modules and survey results  Produce five online modules containing training material and project resources Update The Wordpress website www.peterboroughbuildingsinneed.wordpress.com has been created, maintained and updated by the project officer. It is a free open source Wordpress blog converted to a website. As such it has no current or forward costs for hosting and will continue to run beyond the length of the project. The straightforward content management system allows for quick and flexible updates and editing through the ‘dashboard’, also at no cost. So far it has had over 4000 individual hits, and the daily visitation rate is rising. It has over 40 individual pages and 10 front page posts. The front page also links to the social media aspects of the promotion, the Twitter (@buildingsinneed) and Facebook (www.facebook.com/buildingsinneed) page which allow communication to and from the project on different free platforms. A ‘Box net’ widget on the main page also allows downloads of key documents, flyers for events and fact sheets.
  • 12.
    12 The pages allowthe user to drill down to reports on previous events, all of which have a page on the site. Some of the event pages, under ‘resources’, have embedded Slideshare slideshows if these have been made available by the speaker. These allow the viewer to download or run on screen the lecture slides. It is also free open source software. Alongside slide shows there are photos of the events taking place and in many cases short summaries of key points written by the project officer and uploaded very soon after the event. Bibliographies and links to relevant sites are also embedded where available. Results are added to a Google Map embedded into the site, and can be viewed by the public, so far it has had several hundred hits. The 5 module pages are all populated to a certain degree, with the exception of the final module, which can only be populated once the project final results have been returned. These link to the resource pages and also to slides, PDF documents and e-books where relevant. Starting with the use of social media for promotion, including a Twitter dictionary, downloads of slides on social media and quick guides to using Wordpress and Google maps, as well as Twitter and Facebook, the first module helps to break down the boundaries of online usage for those volunteers not so familiar with the medium. As a result of the workshop on social media, an additional 5 participants are now on Twitter and using it to highlight the built environment.
  • 13.
    13 2) Steering Group Outcomes  Establish a community steering group Update Steering Group established, the initial meeting was held in September 2011, the second in November 2011, and another three meetings held before the completion of the project. The community steering group consists of local representatives from Opportunity Peterborough, Peterborough Regional College and University Centre Peterborough, Peterborough Civic Society, Peterborough City Council, Natural England and English Heritage, St John the Baptist Community Interest Company, Peterborough Environment City Trust, Vivacity Culture and Leisure Trust and Peterborough Cathedral. All of these members are key stakeholders within the City Centre area of Peterborough and within the heritage sector of the Unitary Authority area and beyond. This will allow dissemination of results of the project and legacy. The feedback from this steering group has been valuable in driving the direction of the project, developing contacts, finding volunteers and event suggestions and speakers.
  • 14.
    14 3) Training forvolunteers and the general public Outcomes  Deliver four walking tours and at least 12 master classes as part of the training for participants.  Deliver a historic environment workshop for at least 20 attendees, plus a lunchtime and an evening lecture series with 350 attendees over ten sessions Update 12 lectures in St Johns Church and 17 Masterclasses have been delivered for this project, with over 1000 attendees across the two. The attendance numbers and information on the events are below. Walking tours have been undertaken with volunteer groups and are highlighted in the survey section below. So far four walking tours have been undertaken. Two more for the general public are taking place as part of the Peterborough Heritage Festival. Three of the Masterclasses were delivered by Shape East.
  • 15.
    15 About Shape East: SHAPEEAST is a Centre for Design Excellence and Sustainable Innovation based in the East of England. We are dedicated to providing a positive influence on the quality of urban design and the built environment through supporting the professional community, engaging the public and facilitating debate and understanding between the two. We do this by running a diverse and ever-changing range of events; from professional training seminars to public lectures, local walking tours to school model-making workshops. Our central objectives are to:  Inspire and excite people about the built environment and help them see it through fresh eyes.  Increase understanding of the importance of good planning, urban design, architecture and construction.  Encourage people to participate in the planning and other processes which shape change in their communities.  Prepare the ground for the future by engaging children and young people in built environment issues. http://www.shape-east.org.uk/
  • 16.
    16 Quarry and Geology Visit On April 30 and May 1 student volunteer groups from Peterborough Regional College and University Centre Peterborough, in association with this project and GeoPeterborough (representatives on the Buildings in Need steering group via Natural England) went on a visit to geological sites across the district to see processes relating to the geology of the built environment, and that geology in situ. The agenda was the same both days and 15 students and two tutors attended each day. Jonathan giving a talk in the morning. The morning began with two short lectures by Dr Jonathan Larwood and Dr Colin Prosser, both Geologists with Natural England, followed by a tour of Peterborough city centre, including Cathedral Precincts and the Cathedral itself. The afternoon was a visit to Ketton Quarry followed by a visit to nearby Stamford stone to see the stone being carved before shipping. Colin pointing out red granite setts in the Cathedral Precincts
  • 17.
    17 Using hand lensesto identify oolithic and shelly Lincolnshire limestones.
  • 18.
  • 19.
  • 20.
    20 Lectures 12 arranged intotal, up from 10 originally proposed Total attendees: 718 of 350 total required for whole project. Over 100% increase on original outcome. As a result of this lecture series St John’s Church have continued to run lectures as a way of bringing life to the building. Photos from the lecture series
  • 21.
    21 Lecture Summary Table Number of Date Attendees 11-Oct Victorian Peterborough, Brian White 43 Heritage, History and Regeneration, Steve 18-Oct Bowyer 29 Why is Peterborough City Centre a 25-Oct Conservation Area? Jo Burton 29 01-Nov Georgian Peterborough, Stuart Orme 68 Peterborough Before and After the coming of 08-Nov the Railways, Brian White 58 16-Nov Peterborough Cathedral Archaeology 74 21-Feb- 12 Ghosts of Peterborough, Stuart Orme 92 28-Feb Boongate- A Hamlet to the East, Brian Jones 65 6-Mar A History of Broadway, Stephen Perry 73 Vernacular Architecture, David Grech, English 13-Mar Heritage 63 Peterborough in Architectural Detail, Toby 20-Mar Wood and David Jost 75 27-Mar Wildlife and Buildings, James Fisher 49 TOTAL 718
  • 22.
    22 Masterclasses The Masterclasses alsohave a feedback element to them. Every attendee is given a feedback form and asked to fill it out. This has been overwhelmingly positive, with the content, pace and feedback on the tutors coming in at 100 % good or excellent for every class. Where feedback has been given on room layouts and lighting that is not up to standard this has been taken into account for future Masterclasses and has directly informed them. The attendance at Masterclasses has to be smaller than the lectures and has been nearly100% full so far in terms of capacity. Feedback has also been given through Twitter, as can be seen below from two Masterclass attendees and the Quarry visit.
  • 23.
  • 24.
    24 Total number ofMasterclasses run is 17 from the original 12 suggested including one Heritage workshop run by SPAB out at Sacrewell Farm. Total attendees of Masterclasses: 402
  • 25.
    25 Masterclass Summary Table Date Title Attendees Oct- Social Media and the Built Environment, James 1 26 Mott, Projectbook 24 Nov- 2 05 Archives Masterclass, Richard Hillier, Vivacity 23 Nov- Conservation Area Appraisal Masterclass, Jo 3 10 Burton, Beacon Planning 17 Architectural Drawing Masterclass, John Nov- Biggadike, Peterborough City Council and self 4 17 employed 16 Dec- Architectural Drawing Masterclass 2, John 5 10 Biggadike 12 Historic Environment and Sustainable Futures 06- Masterclass, Shape East with Chris Baines, Peter 6 Feb Rawlings and Dr Andrew Turton 48 7- 7 March House History Masterclass with Dr Nick Barratt 47 Legislation and ‘At Risk’ Masterclass with Shape 20- East, with Nicholas Ray, Lucie Carayon and 8 April Bobby Open 28 28- Heritage Interpretation Masterclass, Stuart 9 April Orme, Vivacity 17 19- May Researching People and Places with Local 10 2011 Studies Centre, Richard Hillier, Archivist 20 24 Maintaining Historic Buildings: Rot, Re-Use and May Calling in the Professionals! Peter Rawlings and 11 Tony Ingram 33 25 Bats and Historic Buildings Masterclass, Antony 12 May Mould 43 8 An A-Z Introduction to Fundraising and Projects, 13 June Alice Kershaw 8 9 14 June SPAB Masterclass workshop at Sacrewell Farm 20 18 Dry Stone Walling Masterclass, Peterborough 15 June Regional College 16 19 Heritage Photography Masterclass Day 1 with 16 June University Centre Peterborough 15 20 Heritage Photography Masterclass Day 2 with 17 June University Centre Peterborough 15 TOTAL 402
  • 26.
    26 4) Building Surveys Outcomes  Carry out a survey of at least 50 buildings 'in need' in Peterborough by volunteer participants. Validate the results and obtain feedback from professional architects and surveyors. Update Three main groups of volunteer surveyors have undertaken surveys. These are the Peterborough Civic Society under the direction of Peter Sargeant, ex Huntingdon Conservation Officer who undertook the entire original Buildings at Risk survey for Huntingdon. Alongside the Civic Society are students from University Centre Peterborough, who covered Broadway within the adjoining Park Conservation Area, and Peterborough Regional College Construction Students (Level 3) who covered the Park Road side of the Park Conservation Area. The Civic Society had the City Centre Conservation Area covered, splitting it into 17 separate sections and dividing amongst themselves. The high levels of
  • 27.
    27 expertise found withinthe society meant they could really hit the ground running on this and results were returned by the end of October. A group of 10 University Centre Peterborough Students undertook training and a tour of Broadway Cemetery and Central Park with the project officer and their tutor Abi Hunt, on October 2nd. They spent the afternoon surveying in pairs and in total surveyed 62 buildings on Broadway. The Peterborough Regional College Construction students undertook training and surveying in early November. They completed 17 surveys and are going
  • 28.
    28 to be visitingthe city centre with the project officer to examine some of the buildings considered at greater need by the Civic Society in depth.
  • 29.
    29 Total buildings surveyedis 247 (239 different buildings) Number of volunteers: 40 Total amount of volunteer time for surveys and project support (excluding time training in Masterclasses): 44 days. Taking into account the differing skill levels required each day this works out as a contribution of £4900 to the project. A toolkit of the results has been created and circulated. This will remain on the project website following the end of the project. Jim Daley, Conservation Officer, speaks to a local agent in the City Centre. Some of the volunteers had never taken part in such a project before, and ‘learning to look up’ and observe was as much of a project outcome as the survey results. One of the surveyors in the City Centre said ‘it has changed my whole attitude to Peterborough’ as it made her more aware of the built environment. Stuart Hobley, Development Manager at HLF East of England, said ”This project has been an exciting and engaging way of giving people from across the community the chance to explore and appreciate their local built heritage. By providing volunteers with opportunities to learn new skills and raising awareness of these buildings at need, local people have taken an important role in championing their historic environment."
  • 30.
    30 Some of thebuildings have been surveyed more than once, with the college students comparing earlier results to their own. Once completed the forms were added to an online map and discussed with the Steering Group for the project, including the Conservation Officer. Below, before (above) and after (below) of Greggs on Cathedral Square. Because the survey had been done and an issue identified the gutters were cleaned during the removal of the Christmas lights. The other actions identified are listed on the Civic Society tables below.
  • 31.
    31 Civic Society CityCentre Survey Results Map of survey area showing results Results Total city centre surveys: 133 Total buildings surveyed 168 ‘In Need’ or ‘On way to in Need’ 90 properties (54%) Currently fine 78 properties. (46%) ‘In Need’ High Priority Properties (listed) Action Poor/ Bad 8 surveys (11 properties) Priestgate opposite Museum Pre application advice given to developers 50 Cowgate (target PSICA phase 3) Laurel Court EH already aware 32 -33 Long Causeway (all issues seem to stem from some blocked gutters!) to get a letter from JD also. Lower priority (non listed) Action North St Letter sent (x2) contact with tenants Met Lounge and Sketchley (Bridge To be reviewed
  • 32.
    32 St), Back entrance toJJB sports through wheel yard 6/6a Cathedral Square NB we arranged to clean gutters whilst removing Christmas decorations On way to ‘In Need’’ Need Number Fair/ in some need 51 Surveys (69 properties) Fair/ Good 10 surveys (10 properties) Action: used as monitoring baseline, some listed properties picked out: Minster Precincts properties have been highlighted to Cathedral. Listed buildings outside of the precincts total 13 properties, all Grade II and predominantly on Cowgate, Priestgate or Westgate. Exception is the Grapevine pub which is II*. Several local list buildings are on the list as well. Currently Fine Need Number Good condition 63 surveys (78 properties) Action; celebration of good maintenance nearer the time.
  • 33.
    33 David Turnock Architects:Summary Report For Buildings in Need BUILDINGS IN NEED SUMMARY REPORT Over the period from October 2011 until February 2012 volunteers from Peterborough Civic Society, Peterborough Regional College and University Centre Peterborough undertook visual surveys of the external fabric of a total of 239 buildings in Peterborough City Centre and the Park Conservation Area. Of this total 168 were within the City Centre Conservation Area, including The Cathedral Precincts, and 71 are located in the Park Conservation Area. Buildings inspected included those on the Statutory List of Listed Buildings. The spreadsheets within this report identify the condition of the external fabric of each building and include a summary designation of the state of general repair at the time of the survey. These are broken down into the following categories: Good/Fine condition Fair/Good Fair Poor This broad categorisation serves to provide a picture of the current state of these 239 buildings, the summary for each area being as follows: City Centre/Cathedral Precincts: Poor 11 Properties 6.5% Fair 69 Properties 41% Fair/Good 10 Properties 6% Good 78 Properties 46.5% Total 168 100% Park Conservation Area:
  • 34.
    34 Poor 10 Properties 15% Fair 30 Properties 42% Fair/Good 1 Property 1% Good 30 Properties 42% Total 71 Properties 100% City Centre Conservation Area If we look firstly at the City Centre area the analysis of these results gives these main observations: 1. There are a relatively small number of buildings currently regarded as poor but these, by the very nature of the issues identified in the survey, are likely to deteriorate at a faster rate. Where water ingress or structural faults are present then the consequent damage to the fabric of the building will take longer to repair and will cost more to remedy.. 2. The number of properties described as “Fair” forms 41% of the total. These are the buildings on the way to being “in need” and form the body of those properties where a regime of regular maintenance by owners would avoid their condition worsening in future. 3. “Fair/Good” and “Good” form the majority of the stock surveyed. Generally it is 1 or 2 items on each building where action is required in order to maintain them in the current category or improve a greater number to be designated as “good”. The conclusion is that regular maintenance of minor problems on these buildings is the best way to ensure that they are at least maintained in their current state and do not deteriorate any further. 4. In some areas it is the rear of buildings that gives greater cause for concern that the front elevations and this is very much the case for Wheel Yard which leads into the Cathedral Precincts. This road is used as the service access to shops fronting Long Causeway and given its nature as a service road, there seems to be little care given to elevation of these buildings. There are occurrences of boundary walls deteriorating, graffiti on doors and seemingly little maintenance given to the building fabric itself. Even where a rear elevation of a building has been designed with some degree of thought such as the rear of the Sports Direct Shop, there is little consideration given to storage of bins and waste which makes the elevation unattractive. Park Conservation Area With respect to the properties within the Park Conservation Area the majority of those surveyed are either Victorian houses converted to commercial use
  • 35.

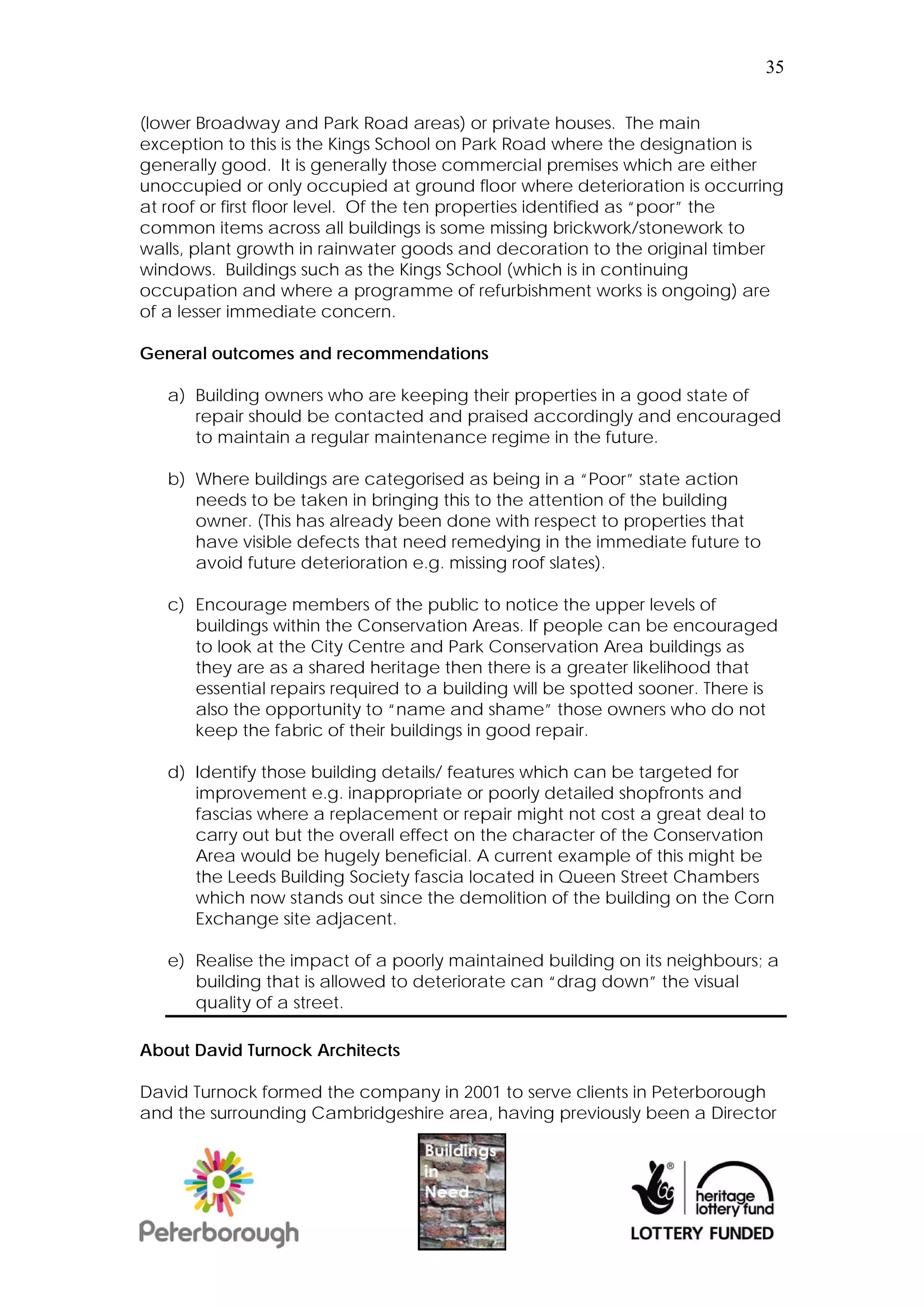

    35 (lower Broadway andPark Road areas) or private houses. The main exception to this is the Kings School on Park Road where the designation is generally good. It is generally those commercial premises which are either unoccupied or only occupied at ground floor where deterioration is occurring at roof or first floor level. Of the ten properties identified as “poor” the common items across all buildings is some missing brickwork/stonework to walls, plant growth in rainwater goods and decoration to the original timber windows. Buildings such as the Kings School (which is in continuing occupation and where a programme of refurbishment works is ongoing) are of a lesser immediate concern. General outcomes and recommendations a) Building owners who are keeping their properties in a good state of repair should be contacted and praised accordingly and encouraged to maintain a regular maintenance regime in the future. b) Where buildings are categorised as being in a “Poor” state action needs to be taken in bringing this to the attention of the building owner. (This has already been done with respect to properties that have visible defects that need remedying in the immediate future to avoid future deterioration e.g. missing roof slates). c) Encourage members of the public to notice the upper levels of buildings within the Conservation Areas. If people can be encouraged to look at the City Centre and Park Conservation Area buildings as they are as a shared heritage then there is a greater likelihood that essential repairs required to a building will be spotted sooner. There is also the opportunity to “name and shame” those owners who do not keep the fabric of their buildings in good repair. d) Identify those building details/ features which can be targeted for improvement e.g. inappropriate or poorly detailed shopfronts and fascias where a replacement or repair might not cost a great deal to carry out but the overall effect on the character of the Conservation Area would be hugely beneficial. A current example of this might be the Leeds Building Society fascia located in Queen Street Chambers which now stands out since the demolition of the building on the Corn Exchange site adjacent. e) Realise the impact of a poorly maintained building on its neighbours; a building that is allowed to deteriorate can “drag down” the visual quality of a street. About David Turnock Architects David Turnock formed the company in 2001 to serve clients in Peterborough and the surrounding Cambridgeshire area, having previously been a Director
  • 36.
    36 at Ruddle WilkinsonArchitects. David succeeded in developing his Client base and moved into new offices designed by the Company at Lynch Wood in 2004. The Company has since grown to a total of 12 staff with two Associates to assist David with the day to day management and now offers a fully independent design consultancy to deliver a high quality, creative and professional, service in both architecture and interior design. A key current interest is in low energy buildings where schemes are being designed to either Very Good or Excellent standard. Staff knowledge base is split approximately 50/50 between Architects and Building Technologists. We feel that this gives us a good balance between design and construction detailing for our projects where design proposals follow good and efficient detailing practice. Our current projects generally range from £250,000 to £10m in value. With respect to the skills and experience of staff members, this is extremely varied including everything from airports, hospitals, railway installations and large retail environments to residential, student accommodation, medical and laboratory developments, historic buildings and churches. Our approach as a Practice is to provide a very thorough service to our Clients throughout the British Isles and beyond.
  • 37.
    37 5) Promotion andCelebration Outcomes  Promote the project and engage with interested local groups at a minimum of six meetings/events e.g. amenity society meetings, Heritage Open Days etc  Celebrate the project's achievements with a launch event for the public, including walking tours led by volunteers, hands on workshops and the publication of the survey results. Update This project has been promoted at the following 6 events (as well as many more!). This promotion has allowed information on the project to reach a wide audience of over 1100 people. Promotion of project at six events e.g. Heritage Open Day, Civic Soc September 10 and Event 1 Heritage Open Days 11 Event 2 Civic Society Meeting 5th September Environment Network Meeting and Allotment Event 3 Workshop Sept 22nd Event 4 Heritage Attractions Group Meeting Sep-13 Event 5 Local History Forum Sep-19 Event 6 University Centre Peterborough Induction Sep-15
  • 38.
    38 Due to insurance issues ithas not been possible to have volunteer walking tours on the night, but a volunteer who is also a guide for the city will be paid to do this aspect of the project.
  • 39.
    39 Below, a selectionof the flyers and posters used to promote the project. The final event took place on June 28th at 6pm in St John’s Church. This is the week after the Peterborough Heritage Festival, and on the evening for late night shopping in the city, and has been decided upon for maximum impact and visibility. Press coverage For this project the project officer and the tutors have been on BBC Radio Peterborough twice, BBC Radio Cambridgeshire three times and community Radio Station ‘Radio Peterborough’ once.
  • 40.
    40 Antony Mould fromthe Cambridge Bat Group on Radio Peterborough. Regular press releases have been sent to the local newspaper (Peterborough Evening Telegraph), and eleven small articles and one larger article about the project have been published. Local free magazine Scene has been supportive. Promotion has been done through PECT’s Greeniversity, RSA Citizen Power’s online ‘Ning’ space, through the Civic Society, Local History Forum, Environmental Network and the Destination Centre, as well as the Heritage Regeneration Officer Bulletin, which reaches over 750 individuals in the area. Local Libraries, coffee shops, Churches, the Town Hall and other public buildings have had flyers left in them. Several different flyers have been produced to target different audiences or for individual events. As well as this a professional flyer and poster has been produced to cover the whole project. These have been printed off ‘in house’ and distributed by hand, post and email. Online the project workshops have featured on Projectbook, Heritage HUB, CBA, the Caravan Club website, Greeniversity, RIBA ‘Love Architecture’ page. Support in Kind. This project has been lucky to receive support in kind from a number of local organisations including Railworld, Peterborough Cathedral, Paper Rhino Design and local experts. This support has totalled over £2000. Costs The total Heritage Lottery Fund grant for the project was £24,200.
  • 41.
  • 42.
  • 43.
    43 Contents 03. Introduction 04. Howto use the Toolkit 12. Sources of Information 13. Appendix A: Letter for Volunteers 14. Appendix B: Survey Form 15. Appendix C: Excel Spreadsheet of results and Google Maps With thanks to English Heritage, Natural England, Peterborough City Council, Peterborough Civic Society, Peterborough Regional College, University Centre Peterborough Front cover images (top) Cowgate, Peterborough, (bottom left) Volunteer in Peterborough, (bottom right) City Centre Building.
  • 44.
    43 Part I: Introduction details of which were turned into online training modules on the project This toolkit is designed to help create a website: baseline of the condition of historic http://peterboroughbuildingsinneed.wo buildings in a discrete area in order to rdpress.com/. assess and monitor the scale of neglect with a view to finding a solution, with Why Peterborough? the overarching idea that prevention is Predominantly the built environment better than cure. This toolkit assists of central Peterborough is of solidly with the identification of interlinked Edwardian and Victorian stock issues, such as vacancy, and low however some buildings date back to maintenance levels, across larger areas the Medieval period, and the street as the first step in resolving such patterns remain unchanged in the problems. majority for the last 900 years. The main project work was undertaken by groups of volunteers in the City Centre Conservation Area and its setting with a small comparison area surveyed in the adjoining Park Conservation Area. Peterborough Unitary Authority contains within it over 1000 listed buildings, which when surveyed in 2009 contained 9 ‘at risk’ structures as designated by the Local Authority and English Heritage, and 1 ‘at risk’ Conservation Area out of 29, the City Centre. Fig. 1 Cathedral Square, Peterborough This toolkit is an outcome of the Heritage Lottery Funded project ‘Peterborough Buildings in Need’, which ran from October 2010 to June 2012. This project focused upon the standing built heritage, both designated and undesignated, of Peterborough City Centre Conservation area. The Buildings in Need project had two strands, the first a survey of the City Centre and comparison with a neighbouring area. The second is a Fig.2. Cowgate, Peterborough series of training and capacity building workshops, masterclasses and lectures for volunteers and the general public,
  • 45.
    44 To avoid moreheritage assets ending up ‘at risk’ and to reduce the many Developed for use in Peterborough factors which put the City Centre City Centre Conservation Area, which Conservation Area into this category, is primarily commercial in nature, the this project was designed to establish survey methodology can be used on which assets are most likely to be just one property or using multiple currently ‘in need’, to raise awareness streets it can be expanded to an entire of what leads to areas and buildings conservation area. being ‘in need’, and to identify maintenance tasks can be done to It is completed on a building by prevent them becoming ‘at risk’. building basis, with one sheet per building. What is the Buildings in Need Toolkit For? What is ‘need’? This tool kit is designed to establish This toolkit defines ‘need’ in a traffic levels of ‘need’ within the built light system relating to the fabric of the environment of a discrete area, using building an issues that lead to lack of individual properties as the default unit maintenance, such as vacancy of some to be surveyed with a picture becoming or all floors: apparent on surveying a collection of buildings. This is aggregated to Very Signs of structural understand the pattern of need across Poor instability or structural an area, and can ultimately enhance the failure Conservation Area management plan. Poor Building with deteriorating masonry, leaking roofs, For this toolkit ‘need’ is defined as a usually accompanied by requirement for maintenance or repair. general disrepair of most It is defined in relation to the English elements of the building Heritage ‘At Risk’ designations. fabric Fair Structurally sound but in Buildings that are suitable for the need of minor repairs or national ‘at risk’ list may be showing signs of lack of discovered through this process, general maintenance (e.g. however lesser degrees of need can blocked gutter, vegetation also be identified. The toolkit results growth) can then be used to create Good Structurally sound and specifications for targeted maintenance weather-tight and well and discrete interventions such as maintained repair, gutter cleaning and re-painting that will address the identified issues, thus preventing further deterioration. Why establish levels of need? The toolkit is for both listed and non In the 2011 report ‘Reducing the risks’ listed properties of all ages and can be English Heritage highlight the used in Conservation areas to establish importance of good maintenance to the common issues for properties. historic environment:
  • 46.
    45 ‘Maintenance of heritage assets A survey such as Buildings in Need is essential if they are not to could be used to highlight areas where become at risk, and to prevent changed policy, strategy or investment those that are already at risk could benefit the built environment. from decaying further and The baseline could form part of a thereby escalating the cost of funding application as part of the their repair and consolidation. ‘evidence of need’ or consultation if Buildings, for instance, decay completed by a community group. rapidly when left empty.’ Buildings in a degree of degradation Who is the Buildings in Need Toolkit affect their setting, both aesthetically, for? economically and also socially. This ties into research done by Kelling and This toolkit provides a standard Wilson in 1982 which resulted in ‘The process for establishing low level risk broken windows theory’ which is a or ‘need’ in an area. It can be used by: criminological theory of the signalling effect of urban disorder and vandalism o Private owners and tenants, on additional crime and anti-social residential and business behaviour. The theory states that occupiers monitoring and maintaining urban o Public amenity groups, Civic environments in a well-ordered Societies, interest groups condition may stop further vandalism o Students and escalation into more serious crime. o Local Planning Authorities This has been used effectively in New York amongst other places. A well presented urban environment is also a catalyst for business investment in an area. Fig.4. Staff from Peterborough City Council use the toolkit to survey buildings. Fig.3. Student volunteer in the Park Area
  • 47.
    46 Part II: Howto Use the answer in every section but do try to if possible. Use your judgement for this. Toolkit You will need to enter the 1) date of Before you start the survey and 2) your name and contact details. Speak to your local Conservation Officer about a project of this nature if Name and/ or number of Building it covers a larger area than one property. In Peterborough we supplied This should be evident from the the volunteers with a letter on headed building itself. If it is not obvious, Council paper that explained what the write the shop name or the last known project was (see Appendix A). shop name here. Equipment Is it listed?  Clipboard  Survey Forms (see Appendix At Peterborough use was made of B) Peterborough Hawkeye online map for  Map volunteers to identify listed buildings  Pencil within the survey area. However, each local planning authority will operate its  High Visibility Vest own GIS system for recording listed  Camera buildings in a map format. If the local  Binoculars (for looking at roof planning authority cannot provide and chimneys etc) access to their GIS system, then the English Heritage Listed Buildings On- The survey is completed on a building line database should be used. Found by building basis and you will need a online here: http://list.english- separate form for each property. heritage.org.uk/ the list has a ‘Quick Appendix B to this document includes Search’ function that should enable the examples of the forms used at listing to be determined if the full Peterborough. Electronic versions can name or part of the name of the be downloaded from the Peterborough property is known. If the location is Buildings in Need project website and known but the property name is not the modified as for use elsewhere. ‘map search’ feature allows an area http://peterboroughbuildingsinneed.wo based search. rdpress.com/ Completing the forms The forms are designed to be completed whilst onsite so include several tick boxes, with some areas for building specific comments as necessary. You do not need to put an
  • 48.
    47 wish to suggest which of these three categories an unlisted building might Listed buildings make up about 2% of be placed. all buildings in England. There are three grades of listing: Grade I A building of exceptional interest, only about 2.5% of all listed buildings are Grade I Grade II* Very important and of more than special interest, approximately 5.5% of listed buildings are of Grade II* Fig.5. Examples of Conservation Area Appraisals and Guidance notes. Grade II Buildings of special interest - these make up Period of Building around 92% of listed buildings At Peterborough most of the buildings in Peterborough City Centre Conservation Area date from the Georgian Period or later. Only a few early timber frame buildings survive In addition to statutory listed buildings along with some Medieval buildings in on the national list, some Local the Cathedral Precincts, being older. Planning Authorities will also have Again a Conservation Area Appraisal their own list of Locally Listed will be helpful in identifying the age of Buildings. The Local Planning individual buildings. For listed Authority will be able to provide buildings this information will be information on their Locally Listed included in the list description (see EH Buildings. listed buildings on line etc) If you know the date or approximate period Finally, there will be unlisted buildings of this building enter it here. that are still identified as making either a positive, neutral or negative Is the property occupied? contribution to the character and appearance of a Conservation Area. Answer either YES on all floors, NO if These will be identified on maps it is unoccupied, UNKNOWN if you within the relevant Conservation Area cannot tell EMPTY UPSTAIRS if it Appraisal prepared by the Local seems to be unused on the upper Planning Authority. Some floors. Tick FOR SALE if there is a Conservation Areas do not have an sale board. adopted Appraisal, in which case volunteers undertaking a survey may
  • 49.
    48 Current Use Is ita shop, cafe, estate agents? Please fill in the main use and function of the building here. Fig.8. The Draper’s Arms, Peterborough Is there any evidence it was used as something else? For example at Peterborough the Drapers Arms was once a Drapers shop. If you do not know leave this answer blank. Fig.6 and Fig.7 Shop fascias in Peterborough City Centre photographed by Buildings in Need Volunteer Evidence of previous use? Windows Do they look sound? Are they boarded? There may be unpainted frames and signs of decaying or rotting
  • 50.
    49 woodwork, or signsof cracking to the roof1? Is the roof line straight or glass. Do they look original or are bowing? Note this in the other section they modern replacements? if this is the case. Also what are the condition of the chimneys (if visible). Tall chimneys will often bow towards the south (due to salts being deposited in the bed joints on the north side, while the sun and wind dry out the south side) Fig 12, 13 and 14: A hole in a roof, bowing roofline and bituminous covering on a roof, potentially disguising issues. What kind of condition are the walls visible from the public footpath in? There may be evidence of damage through spalling stonework/ bricks, missing mortar, inappropriate repairs, cracks of all sizes, bowing or bulging in the wall (eye along the line of the Fig 9. 10 and 11: Protected and boarded windows, and a wall), damp, staining, defective render, smashed one in Peterborough City Centre. 1 The English Heritage Guidance note on thatch contains the following sentence ‘Bear in mind that the Roof Condition performance of thatch is not linked intimately to its appearance, and like a much-repaired wall a roof can present a motley appearance without being inferior to a much neater looking new job’. (English Heritage, Are there missing slates or tiles? Is Thatch and Thatching, 2000. Available online here: there evidence of decay in a thatched http://www.english- heritage.org.uk/content/publications/docs/thatchandth atching.pdf )
  • 51.
    50 rot in exposedtimber framing or vandalism Fig 15 and 16. Damaged paintwork and stone/brick work Guttering and downpipes Do they seem blocked, is there Fig 17 and 18. Growth in gutter hopper heads. evidence for water running down the sides of buildings, such as patches of Evidence of Missing Architectural green or plaster damage? Is there Features? evidence of plant growth in the tops of gutters or hopper heads? If there is any evidence of missing architectural features which for this toolkit is defined as anything original to the building that has now disappeared, perhaps leaving a gap or differently coloured render or missing decorative ridge tiles, door knockers, boot scrapers etc, note this here.
  • 52.
    51 masonry, leaking roofs, usually accompanied by general disrepair of most elements of the building fabric Fair Structurally sound but in need of minor repairs or showing signs of lack of general maintenance Good Structurally sound and weather-tight Any other comments Add in anything else here. For each property a digital photo will also be required. For each building take a picture of the front elevation (the section of the building facing the street) and any details you feel are of particular interest, or defects you wish to record. About 4 pictures per building at a maximum should be about right. Fig 18 and 19:Missing features. General Condition? This section will create the traffic light coding when put onto a map. You will have to use the previous answers and your own judgement for this rating. Select one of the following: Very Signs of structural Poor instability or structural failure Poor Building with deteriorating
  • 53.
    52 Estimate of urgency of works? If works seem urgent make a note here, this is helpful for absentee landlords to have an idea of urgency for the maintenance required. The proviso is obviously that this is the opinion of one person. What to do with your results Fig 20, 21, 22 and 23 Examples of photos of one property taken by volunteers for the Buildings in Need Once you have completed all the forms project: for an area it is a good idea to meet as a group to first moderate your results to ensure a degree of consistency, then to meet with your Conservation Officer to discuss your findings. For Peterborough Buildings in Need the findings were transferred into an Excel spreadsheet that was then colour coded and this data transferred onto a Google Map so that the individual blocks of colour established by the traffic light system could be seen in an aggregated overview. See Appendix C for examples of the spreadsheets and
  • 54.

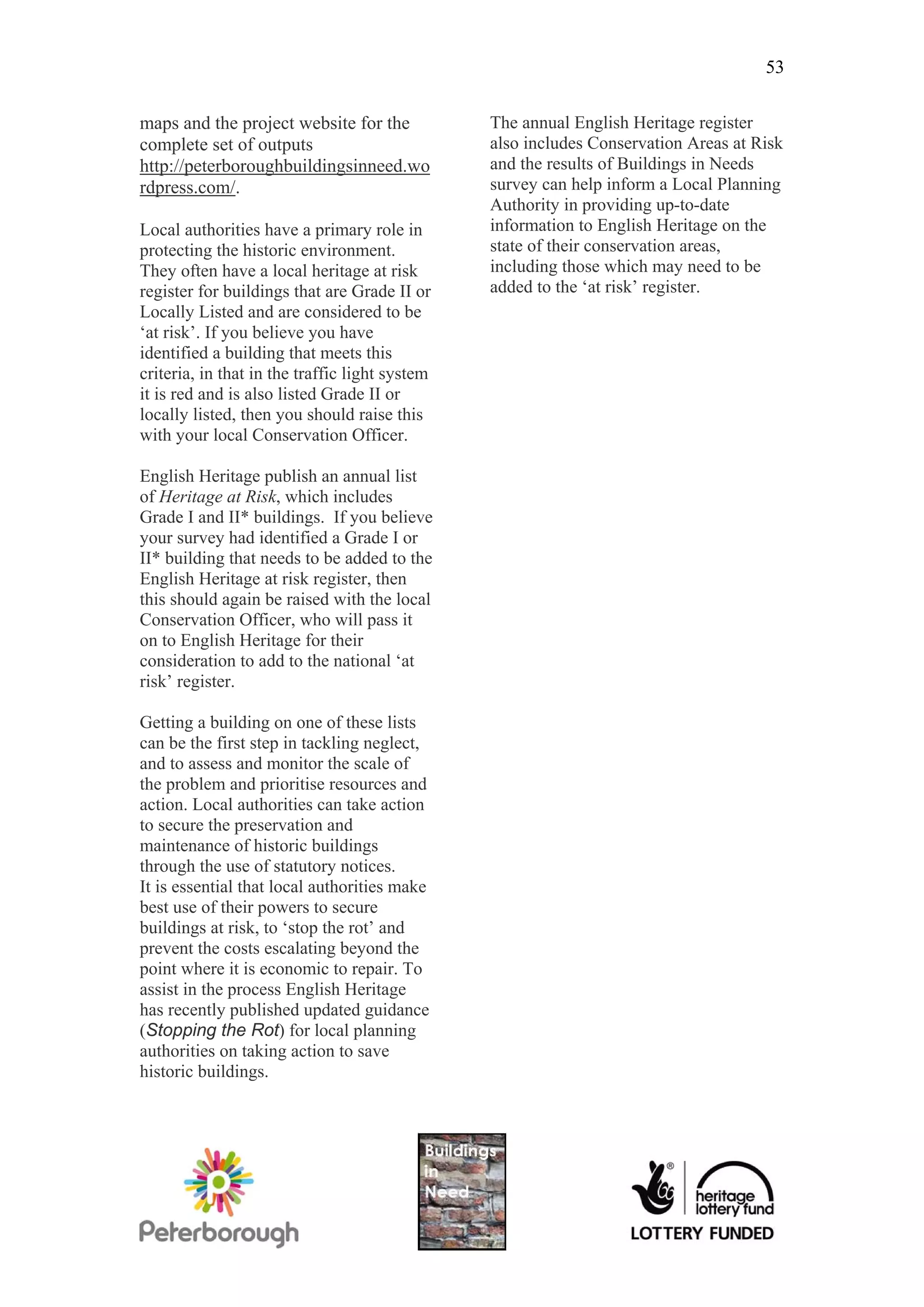

    53 maps and theproject website for the The annual English Heritage register complete set of outputs also includes Conservation Areas at Risk http://peterboroughbuildingsinneed.wo and the results of Buildings in Needs rdpress.com/. survey can help inform a Local Planning Authority in providing up-to-date Local authorities have a primary role in information to English Heritage on the protecting the historic environment. state of their conservation areas, They often have a local heritage at risk including those which may need to be register for buildings that are Grade II or added to the ‘at risk’ register. Locally Listed and are considered to be ‘at risk’. If you believe you have identified a building that meets this criteria, in that in the traffic light system it is red and is also listed Grade II or locally listed, then you should raise this with your local Conservation Officer. English Heritage publish an annual list of Heritage at Risk, which includes Grade I and II* buildings. If you believe your survey had identified a Grade I or II* building that needs to be added to the English Heritage at risk register, then this should again be raised with the local Conservation Officer, who will pass it on to English Heritage for their consideration to add to the national ‘at risk’ register. Getting a building on one of these lists can be the first step in tackling neglect, and to assess and monitor the scale of the problem and prioritise resources and action. Local authorities can take action to secure the preservation and maintenance of historic buildings through the use of statutory notices. It is essential that local authorities make best use of their powers to secure buildings at risk, to ‘stop the rot’ and prevent the costs escalating beyond the point where it is economic to repair. To assist in the process English Heritage has recently published updated guidance (Stopping the Rot) for local planning authorities on taking action to save historic buildings.
  • 55.
    54 Sources of Information: HELM website: http://www.helm.org.uk/ Peterborough Buildings in Need project website: http://peterboroughbuildingsinneed.wo rdpress.com/ Heritage at Risk: http://www.english- heritage.org.uk/caring/heritage-at-risk/ Reducing Risk, 2011 available at http://www.english- heritage.org.uk/content/publications/do cs/acc-reducing-risks-2011.pdf Stopping the Rot guidance to enforcement actions Local Authorities can take for historic buildings: http://www.english- heritage.org.uk/publications/stoppingth erot/ SPAB maintenance site: http://www.maintainyourbuilding.org. uk/pages/maintenance.html Stitch in Time Guidance available online here: http://www.dlrcoco.ie/conservation/IHBC.pdf
  • 56.
    55 Appendix A –Letter for volunteers Telephone: 01733 317480 Facsimile: 01733 453505 E-Mail: alice.kershaw@peterborough.gov.uk Please ask for: Ms A Kershaw Our Ref: AK/BinN Opportunity Peterborough Stuart House East Wing Your Ref: St John’s Street Peterborough PE1 5DD Peterborough Direct Minicom 01733 452421 DX 12310 Peterborough 1 OPPORTUNITY PETERBOROUGH LOCAL BUILDINGS IN NEED To whom it may concern The person carrying out this Buildings in Need survey is a volunteer from the Peterborough Civic Society who is working on behalf of Opportunity Peterborough and the Conservation Team at Peterborough City Council. The aim of the project is to identify potential buildings ‘in need’ of maintenance in the city centre. The initial survey is being carried out throughout the City Centre Conservation Area during the autumn of 2011. Should you require any additional information or confirmation of the above work please call either Jim Daley (Principal Built Conservation Officer) on Peterborough 453522 or Alice Kershaw (Heritage Regeneration Officer) on Peterborough 317480. Thank you for your understanding and cooperation. Alice Kershaw Heritage Regeneration Officer
  • 57.
    56 Appendix B –Survey Form Buildings in Buildings in Need Need Survey Form Www.PeterboroughBuildingsinNeed.Wordpress.com 1. Date………………………………………… 2. Surveyors Details Name of surveyor Email Address: Phone Number: 3. Please enter the property details. Please enter the property details. Address of Property Address 2: Listed? (if known) Yes/No List Grade? (if known) 4. Is the property occupied? Yes No Unknown Empt y upstairs For Sale Current Use and any evidence of Previous Use
  • 58.
    57 5. Condition ofwindows Please tick or underline Good - structurally sound, well maintained and painted Fair - showing some lack of maintenance, poor decoration Poor - in need of maintenance Very bad - broken or boarded, rot 6. Condition of roof if visible Please tick or underline Good – well maintained, wind and weather tight Fair – wind and weather tight, no visible deterioration Poor – slipped slates Very Bad – missing slates, holes Is there evidence of previous repair eg mortar on the roof, different colour patches? Describe: Other (please specify) 7. Condition of visible walls? (Front or side walls visible from public footpath) Many Some No evidence Missing stonework/ bricks Missing mortar Inappropriate mortar repairs Small cracks Major cracks Evidence of wall movement Damp/ water staining Graffiti Peeling plaster or render Other (please specify) ………………………………………………………………………………………………… …………………………………………………………………………………………………
  • 59.
    58 8. Do therainwater goods appear sound? Gutt ers with plant growth visible Cracks No obvious problem 9. Is there evidence of missing or damaged architectural features? What? ……………………………………………………………………………………… ……………………………………………………………………………………… ……………………………………………………………………………………… ……………………………………………………… 10. General condition of visible parts of the building? very bad (st ructural failure or signs of st ructural instabilit y) poor (building wit h det eriorat ing masonry, leaking roofs, usually accomp det erioration of most element s of t he building fabric) fair (st ructurally sound but in need of minor repairs or showing signs of lac maint enance good condit ion (st ruct urally sound and weather-tight) 11. Any further comments ………………………………………………………………………………………………….. ………………………………………………………………………………………………….. ………………………………………………………………………………………………….. ………………………………………………………………………………………………….. 12. Estimate of urgency of works? In the next: 3 Months 6-9 Months 12 Months Please include a shot of the building and any issues if possible. Please make a note of the time you spent recording this building………………………. Please return by post to Alice Kershaw, Opportunity Peterborough, Stuart House East, St Johns Street, Peterborough, PE1 5DD or email to alice.kershaw@peterborough.gov.uk
  • 60.

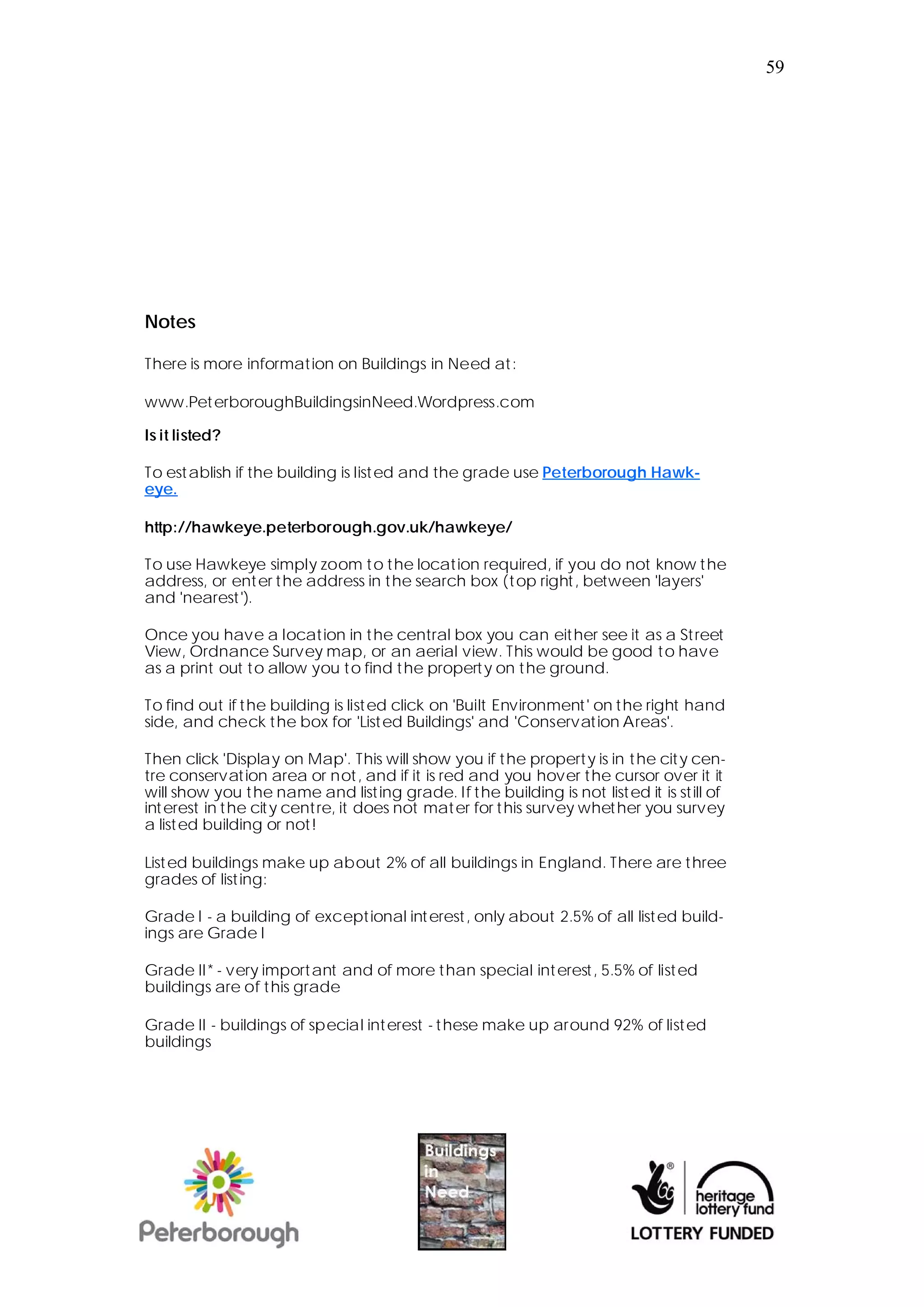

    59 Notes There is moreinformation on Buildings in Need at: www.Pet erboroughBuildingsinNeed.Wordpress.com Is it listed? To est ablish if the building is list ed and the grade use Peterborough Hawk- eye. http://hawkeye.peterborough.gov.uk/hawkeye/ To use Hawkeye simply zoom t o the location required, if you do not know t he address, or enter the address in the search box (t op right , between 'layers' and 'nearest'). Once you have a location in t he central box you can either see it as a St reet View, Ordnance Survey map, or an aerial view. This would be good to have as a print out to allow you to find t he propert y on t he ground. To find out if the building is listed click on 'Built Environment ' on the right hand side, and check the box for 'Listed Buildings' and 'Conservation Areas'. Then click 'Display on Map'. This will show you if the property is in t he cit y cen- tre conservat ion area or not , and if it is red and you hover the cursor over it it will show you t he name and list ing grade. If the building is not listed it is st ill of int erest in the cit y cent re, it does not mater for t his survey whether you survey a listed building or not! List ed buildings make up about 2% of all buildings in England. There are three grades of list ing: Grade I - a building of exceptional int erest , only about 2.5% of all listed build- ings are Grade I Grade II* - very important and of more than special int erest, 5.5% of list ed buildings are of this grade Grade II - buildings of special interest - t hese make up around 92% of listed buildings
  • 61.
    60 Appendix C: ExcelSpreadsheet of results and Google Maps
  • 64.
    Alice Kershaw Heritage RegenerationOfficer Email: alice.kershaw@peterborough.gov.uk Website: www.opportunitypeterborough.co.uk/heritage Project website: http://peterboroughbuildingsinneed.wordpress.com/
