Behavior Driven Development

           Ajay Danait

           Global Agile Strategist
      Stixis Technologies, Bangalore

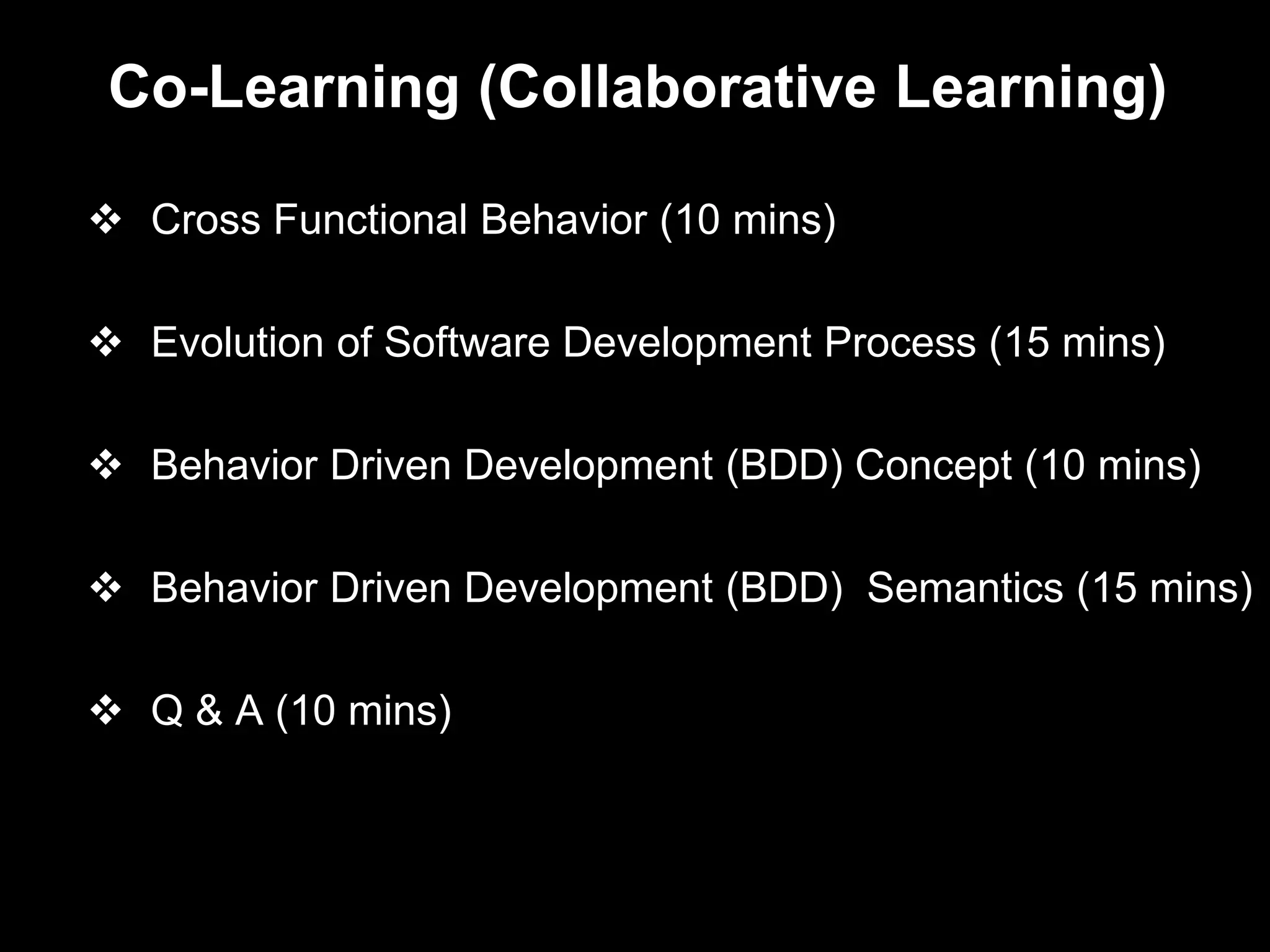

Co-Learning (Collaborative Learning)

 Cross Functional Behavior (10 mins)

 Evolution of Software Development Process (15 mins)

 Behavior Driven Development (BDD) Concept (10 mins)

 Behavior Driven Development (BDD) Semantics (15 mins)

 Q & A (10 mins)

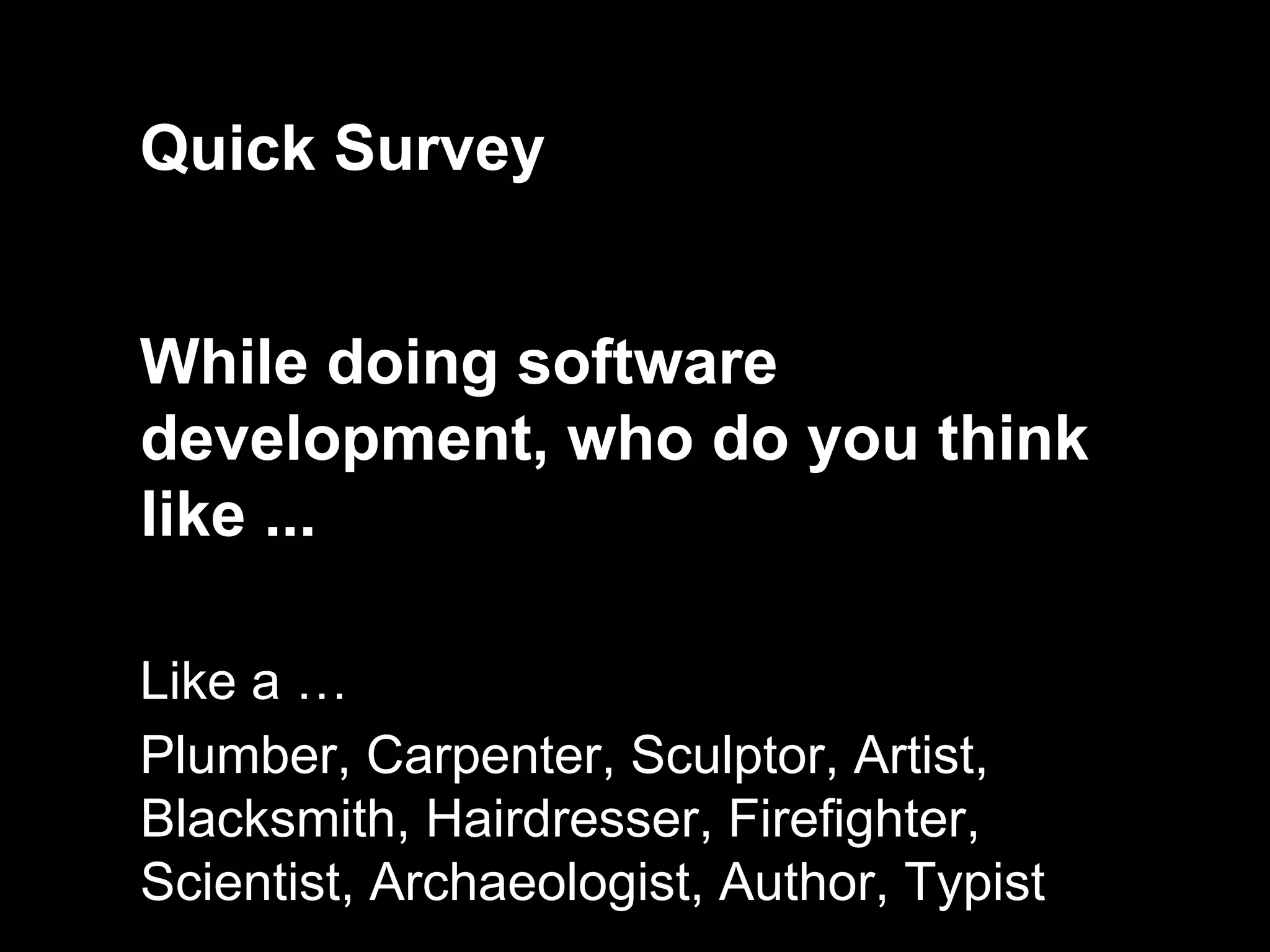

Quick Survey

While doing software
development, who do you think
like ...

Like a …
Plumber, Carpenter, Sculptor, Artist,
Blacksmith, Hairdresser, Firefighter,
Scientist, Archaeologist, Author, Typist

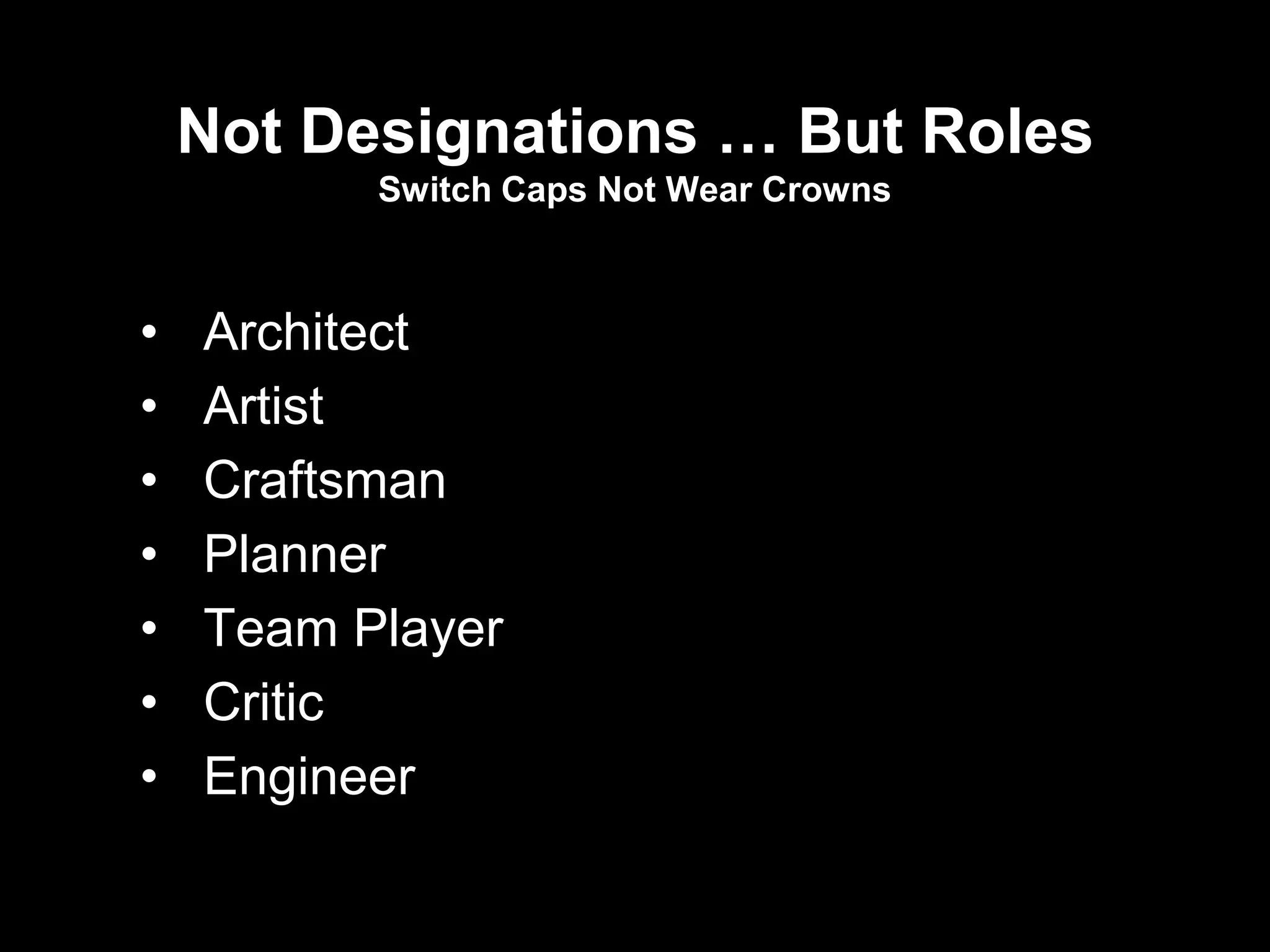

Not Designations … But Roles
          Switch Caps Not Wear Crowns

•   Architect
•   Artist
•   Craftsman
•   Planner
•   Team Player
•   Critic
•   Engineer

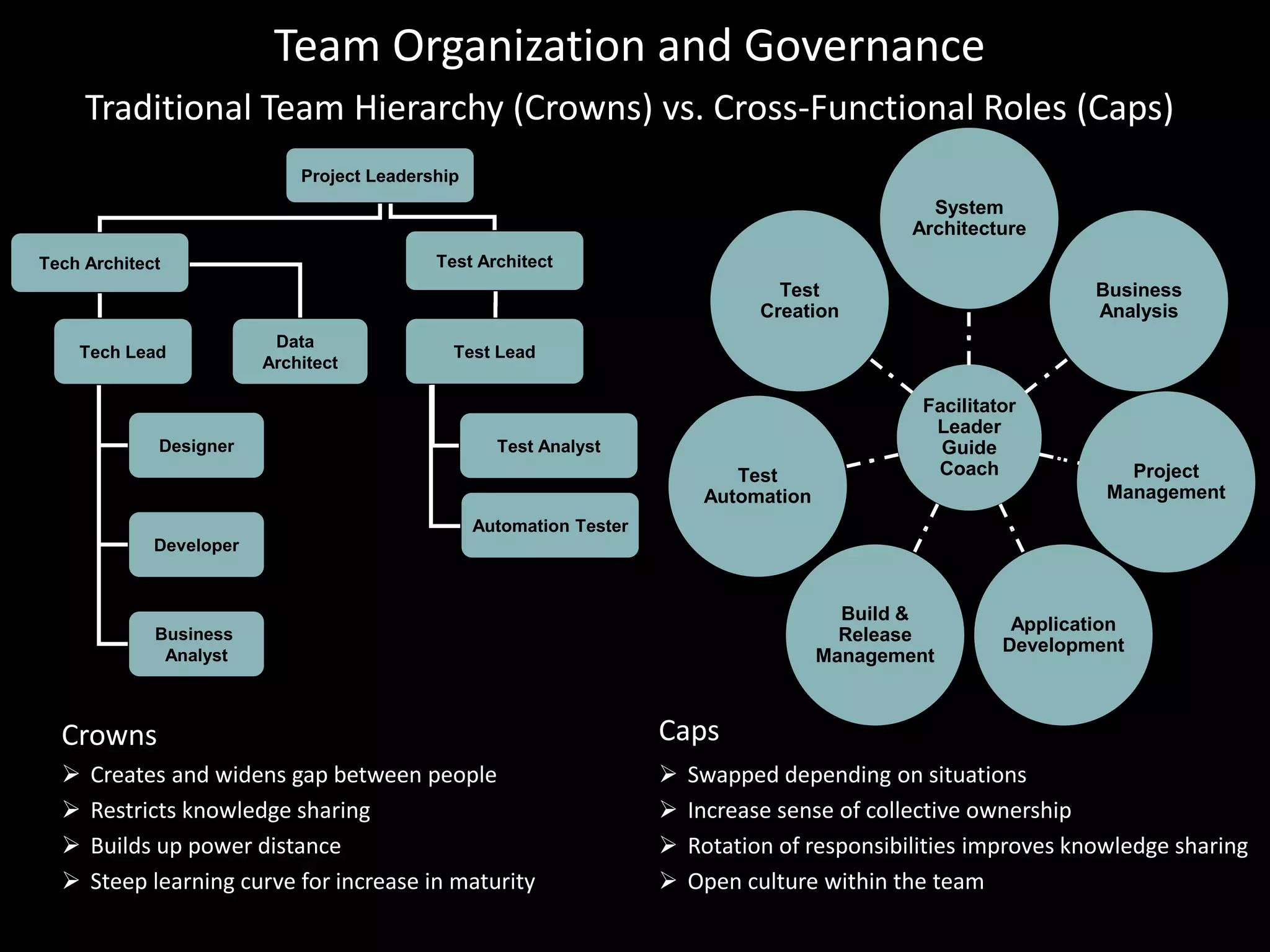

Team Organization and Governance
      Traditional Team Hierarchy (Crowns) vs. Cross-Functional Roles (Caps)
                             Project Leadership
                                                                                                  System
                                                                                                Architecture
Tech Architect                              Test Architect
                                                                                   Test                            Business
                                                                                 Creation                          Analysis
                          Data
    Tech Lead                                 Test Lead
                         Architect

                                                                                                 Facilitator
                                                                                                  Leader
             Designer                               Test Analyst                                   Guide
                                                                              Test                Coach               Project
                                                                           Automation                               Management
                                                  Automation Tester
             Developer

                                                                                          Build &
                                                                                                           Application
             Business                                                                     Release
                                                                                                          Development
              Analyst                                                                   Management

  Crowns                                                              Caps
     Creates and widens gap between people                              Swapped depending on situations
     Restricts knowledge sharing                                        Increase sense of collective ownership
     Builds up power distance                                           Rotation of responsibilities improves knowledge sharing
     Steep learning curve for increase in maturity                      Open culture within the team
Quick Opinion

 When do you say a software project has
               "failed" ?

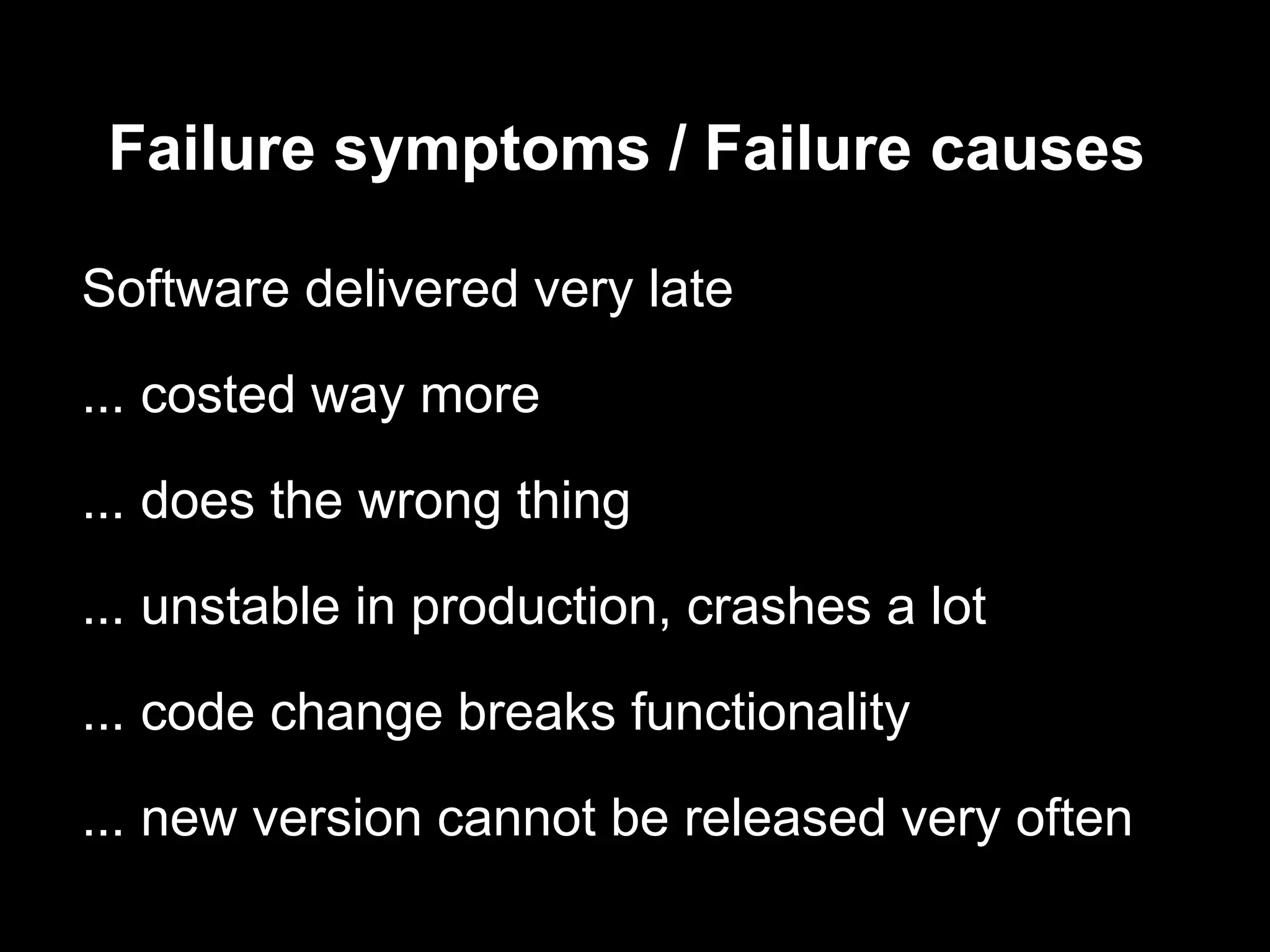

Failure symptoms / Failure causes

Software delivered very late
... costed way more

... does the wrong thing

... unstable in production, crashes a lot

... code change breaks functionality

... new version cannot be released very often

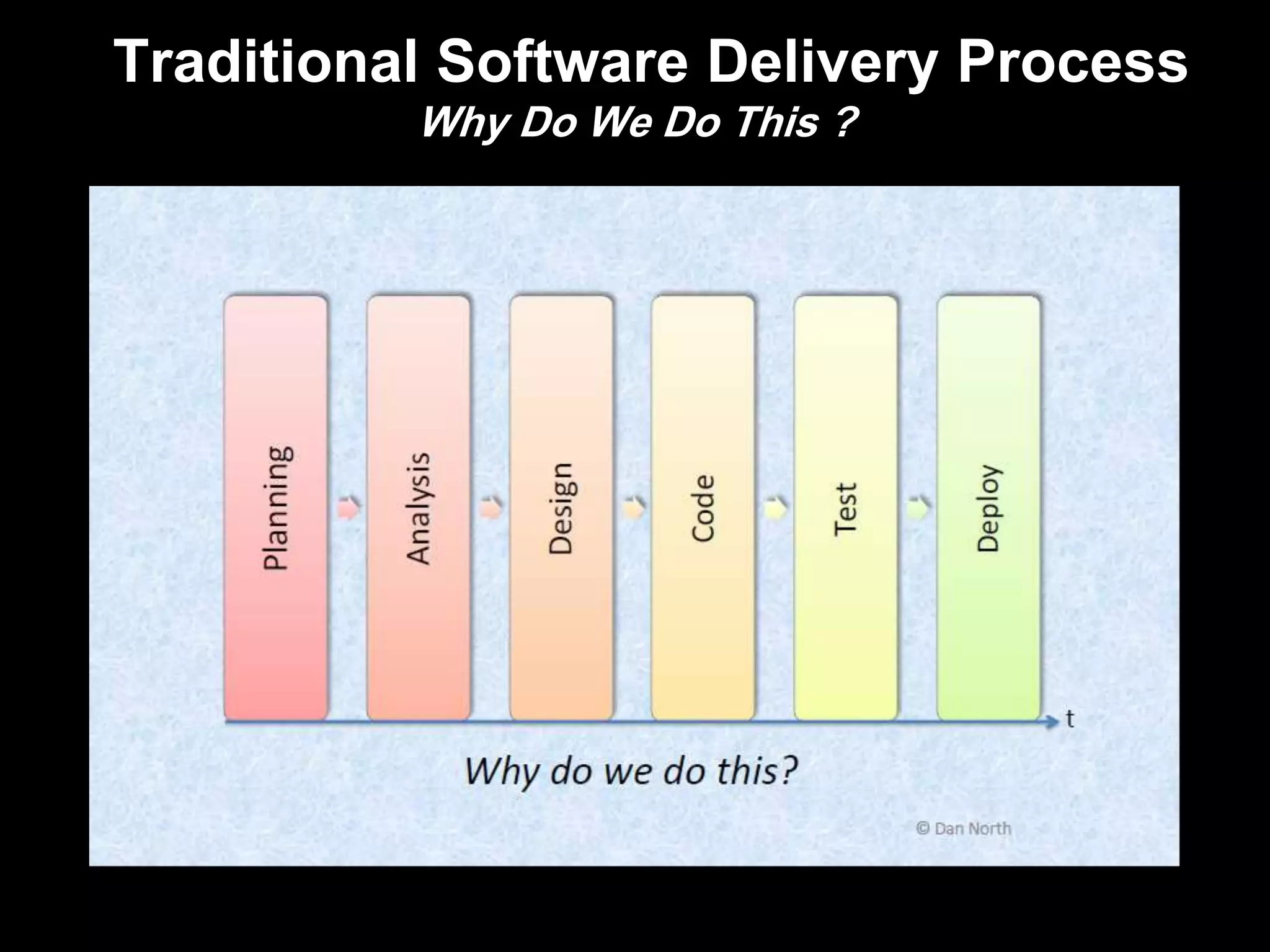

Traditional Software Delivery Process
          Why Do We Do This ?

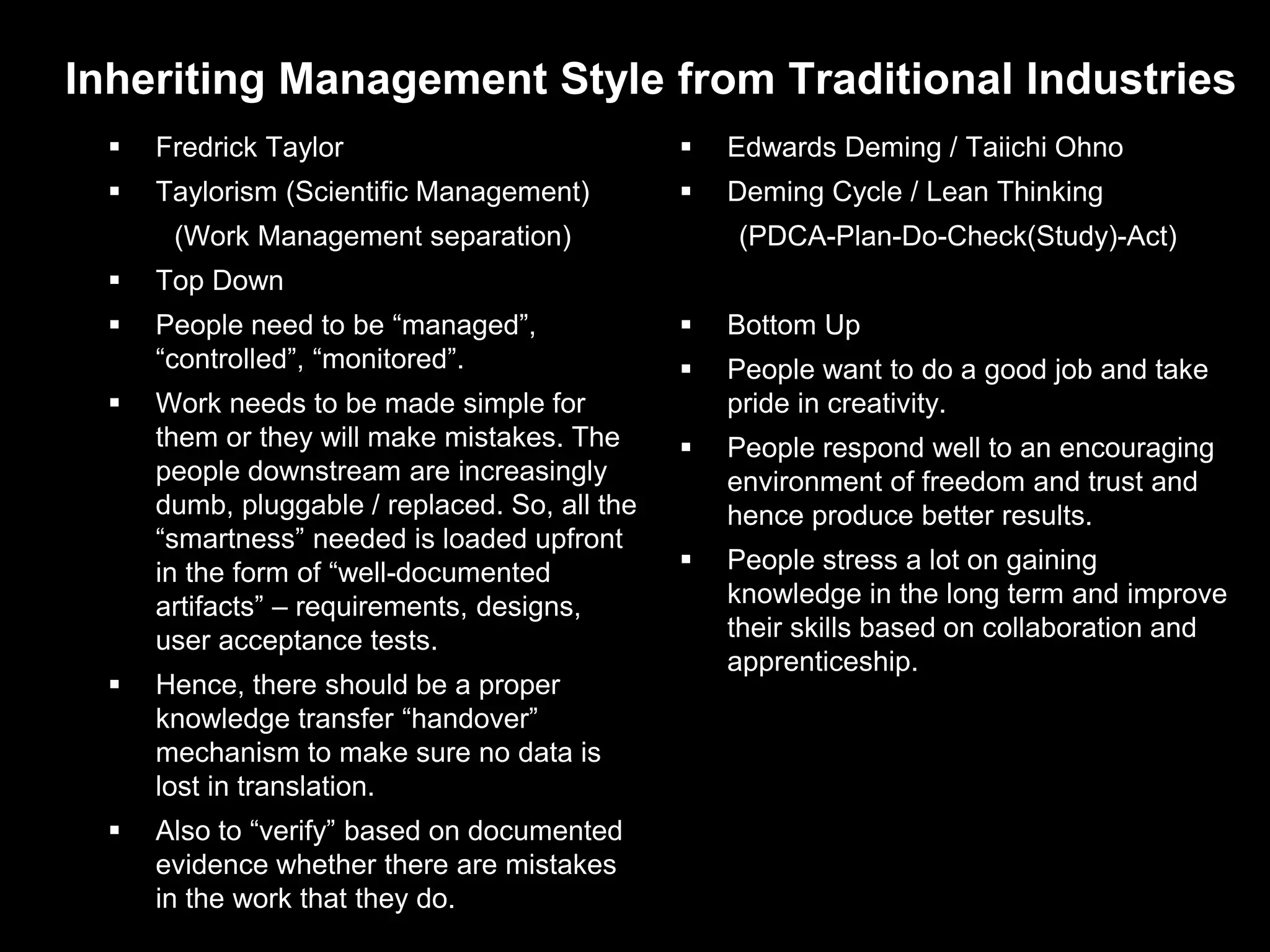

Inheriting Management Style from Traditional Industries
     Fredrick Taylor                              Edwards Deming / Taiichi Ohno
     Taylorism (Scientific Management)            Deming Cycle / Lean Thinking
       (Work Management separation)                 (PDCA-Plan-Do-Check(Study)-Act)
     Top Down
     People need to be “managed”,                 Bottom Up
      “controlled”, “monitored”.                   People want to do a good job and take
     Work needs to be made simple for              pride in creativity.
      them or they will make mistakes. The         People respond well to an encouraging
      people downstream are increasingly            environment of freedom and trust and
      dumb, pluggable / replaced. So, all the       hence produce better results.
      “smartness” needed is loaded upfront
      in the form of “well-documented              People stress a lot on gaining
      artifacts” – requirements, designs,           knowledge in the long term and improve
      user acceptance tests.                        their skills based on collaboration and
                                                    apprenticeship.
     Hence, there should be a proper
      knowledge transfer “handover”
      mechanism to make sure no data is
      lost in translation.
     Also to “verify” based on documented
      evidence whether there are mistakes
      in the work that they do.

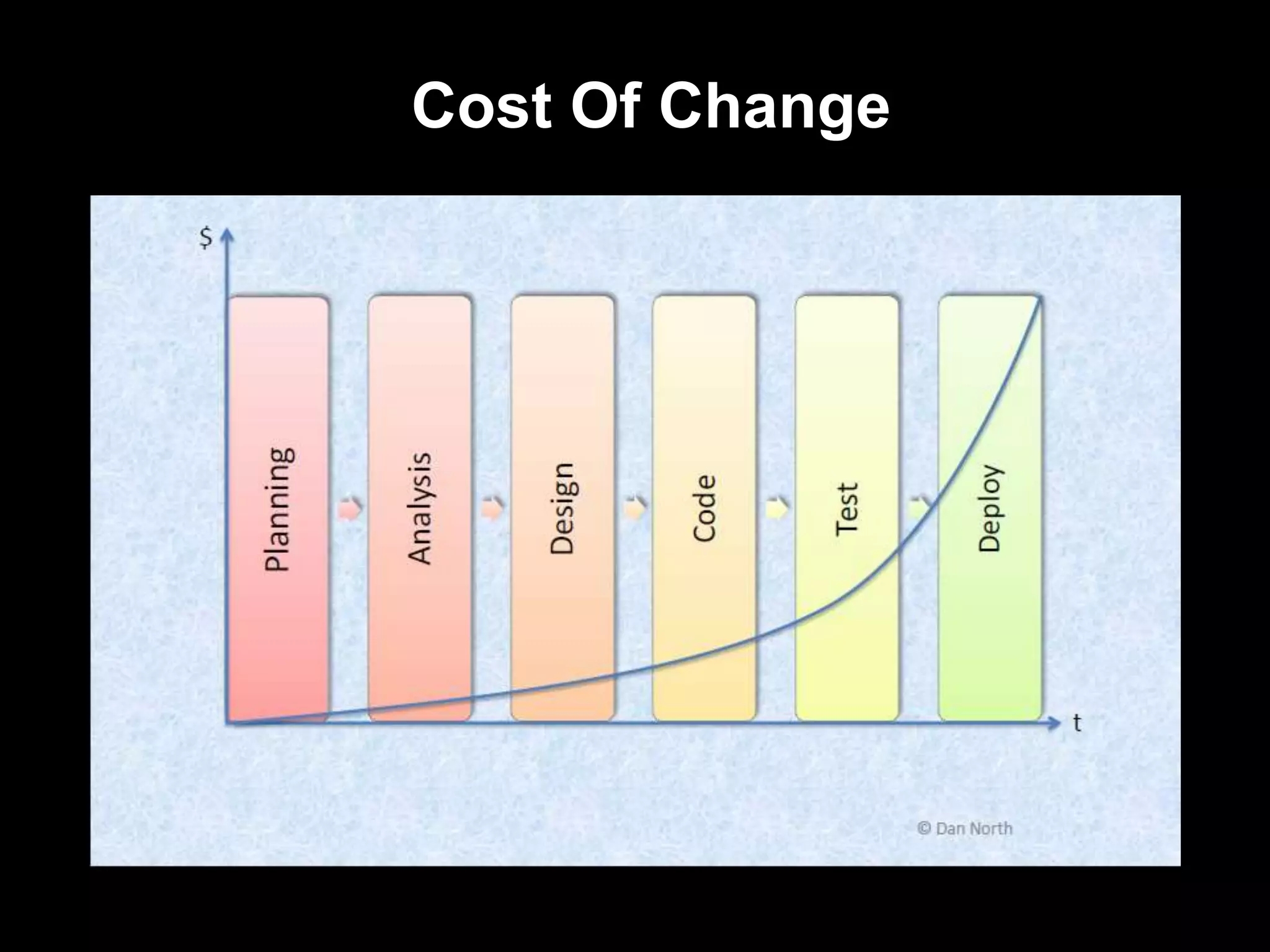

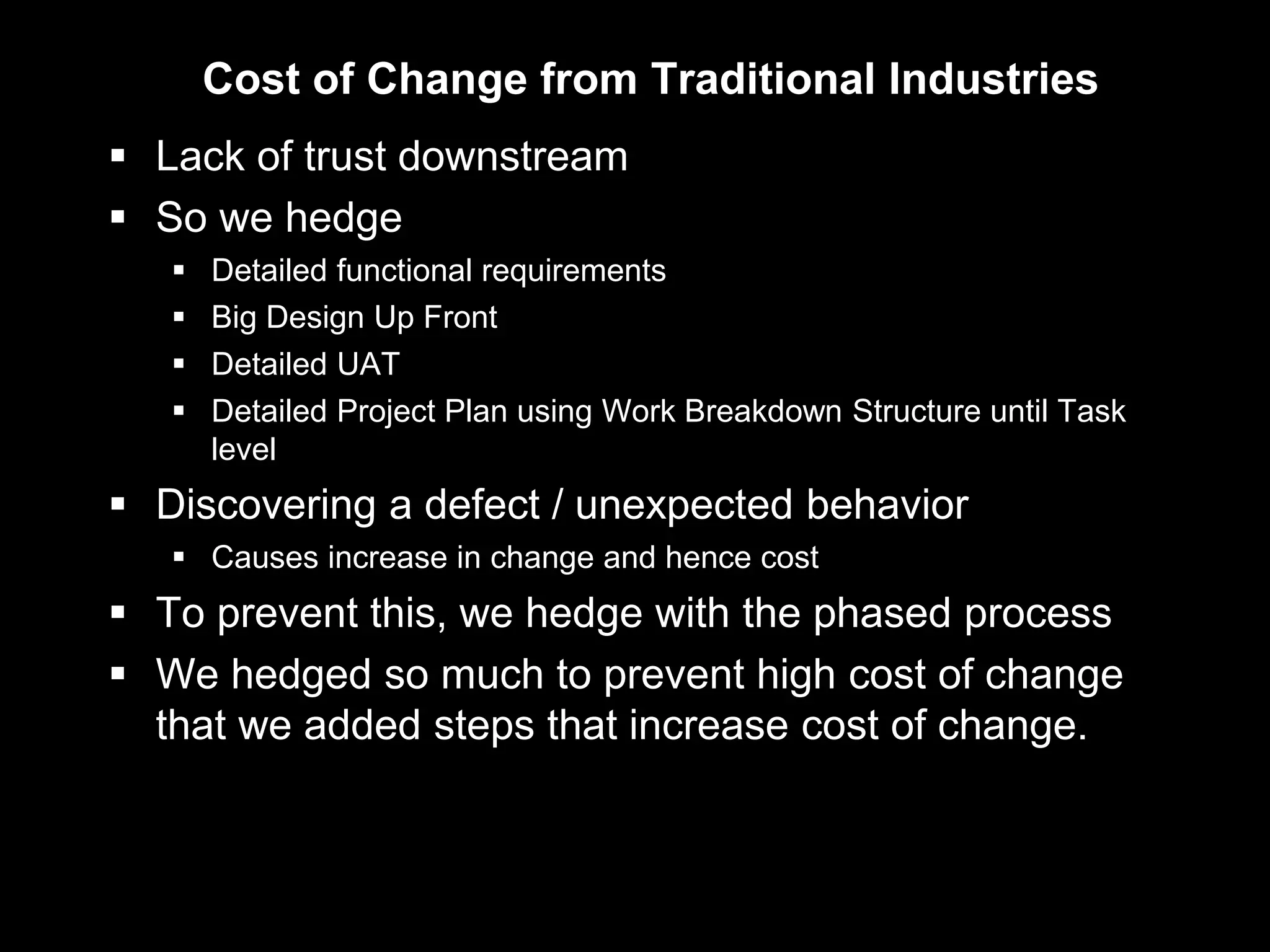

Cost Of Change
Cost of Change from Traditional Industries
 Lack of trust downstream
 So we hedge
      Detailed functional requirements
      Big Design Up Front
      Detailed UAT
      Detailed Project Plan using Work Breakdown Structure until Task
       level
 Discovering a defect / unexpected behavior
    Causes increase in change and hence cost
 To prevent this, we hedge with the phased process
 We hedged so much to prevent high cost of change
  that we added steps that increase cost of change.

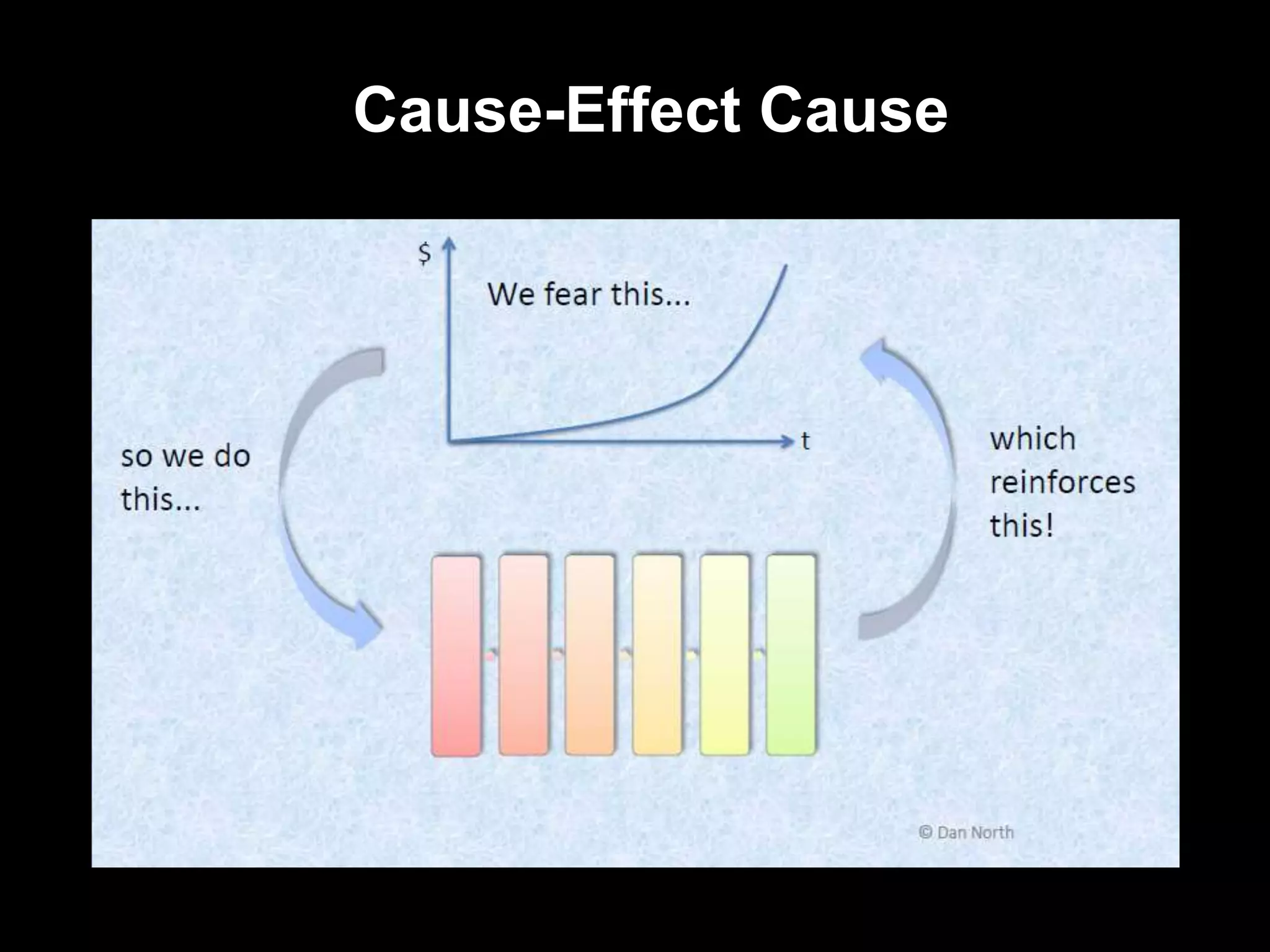

Cause-Effect Cause

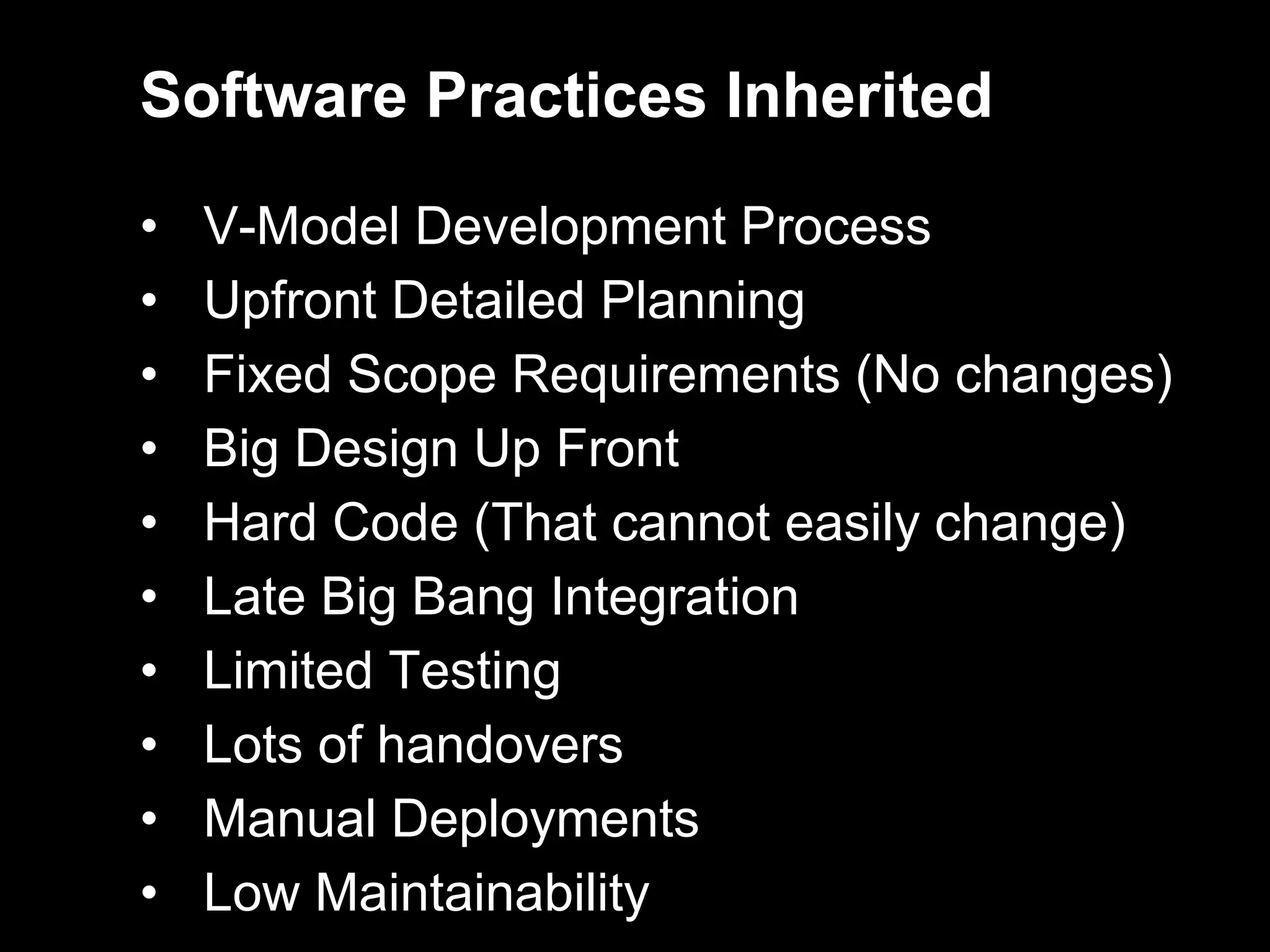

Software Practices Inherited

•   V-Model Development Process
•   Upfront Detailed Planning
•   Fixed Scope Requirements (No changes)
•   Big Design Up Front
•   Hard Code (That cannot easily change)
•   Late Big Bang Integration
•   Limited Testing
•   Lots of handovers
•   Manual Deployments
•   Low Maintainability

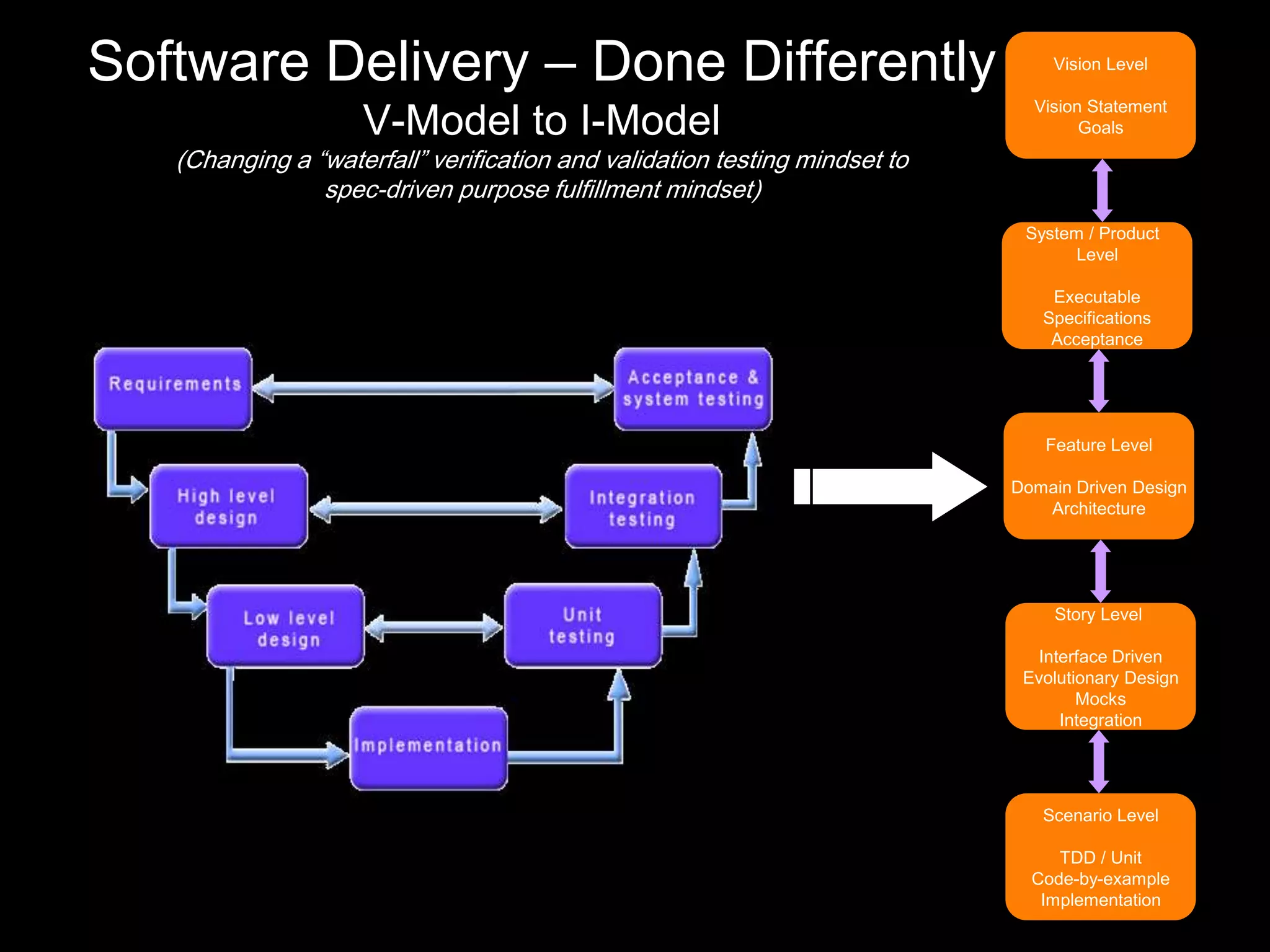

Software Delivery – Done Differently                                            Vision Level

                                                                              Vision Statement
                    V-Model to I-Model                                              Goals
   (Changing a “waterfall” verification and validation testing mindset to
                spec-driven purpose fulfillment mindset)
                                                                             System / Product
                                                                                   Level

                                                                                Executable
                                                                               Specifications
                                                                                Acceptance

                                                                               Feature Level

                                                                            Domain Driven Design
                                                                               Architecture

                                                                                Story Level

                                                                               Interface Driven
                                                                             Evolutionary Design
                                                                                    Mocks
                                                                                  Integration

                                                                               Scenario Level

                                                                                 TDD / Unit
                                                                              Code-by-example
                                                                               Implementation
Levels of Planning
   Who?                        Executive Mgmt.
               Vision
   Why?                        Product Management

What?          Product           Product Owner
                                    Product Owner,
When?          Release
                                    Stakeholders,
                                    Team
How?           Iteration          Product Owner,
                                  Team

               Daily             Team

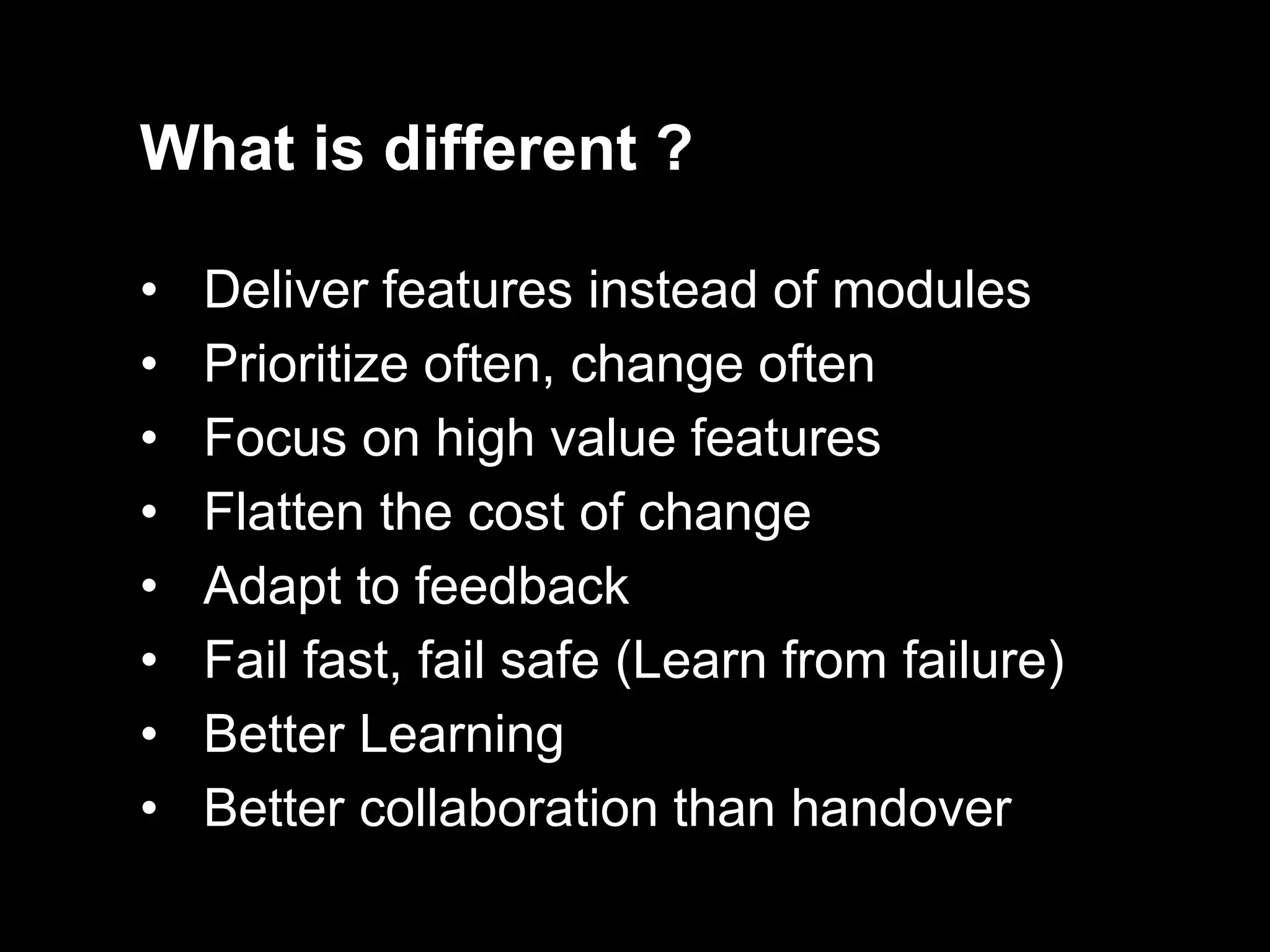

What is different ?

•   Deliver features instead of modules
•   Prioritize often, change often
•   Focus on high value features
•   Flatten the cost of change
•   Adapt to feedback
•   Fail fast, fail safe (Learn from failure)
•   Better Learning
•   Better collaboration than handover

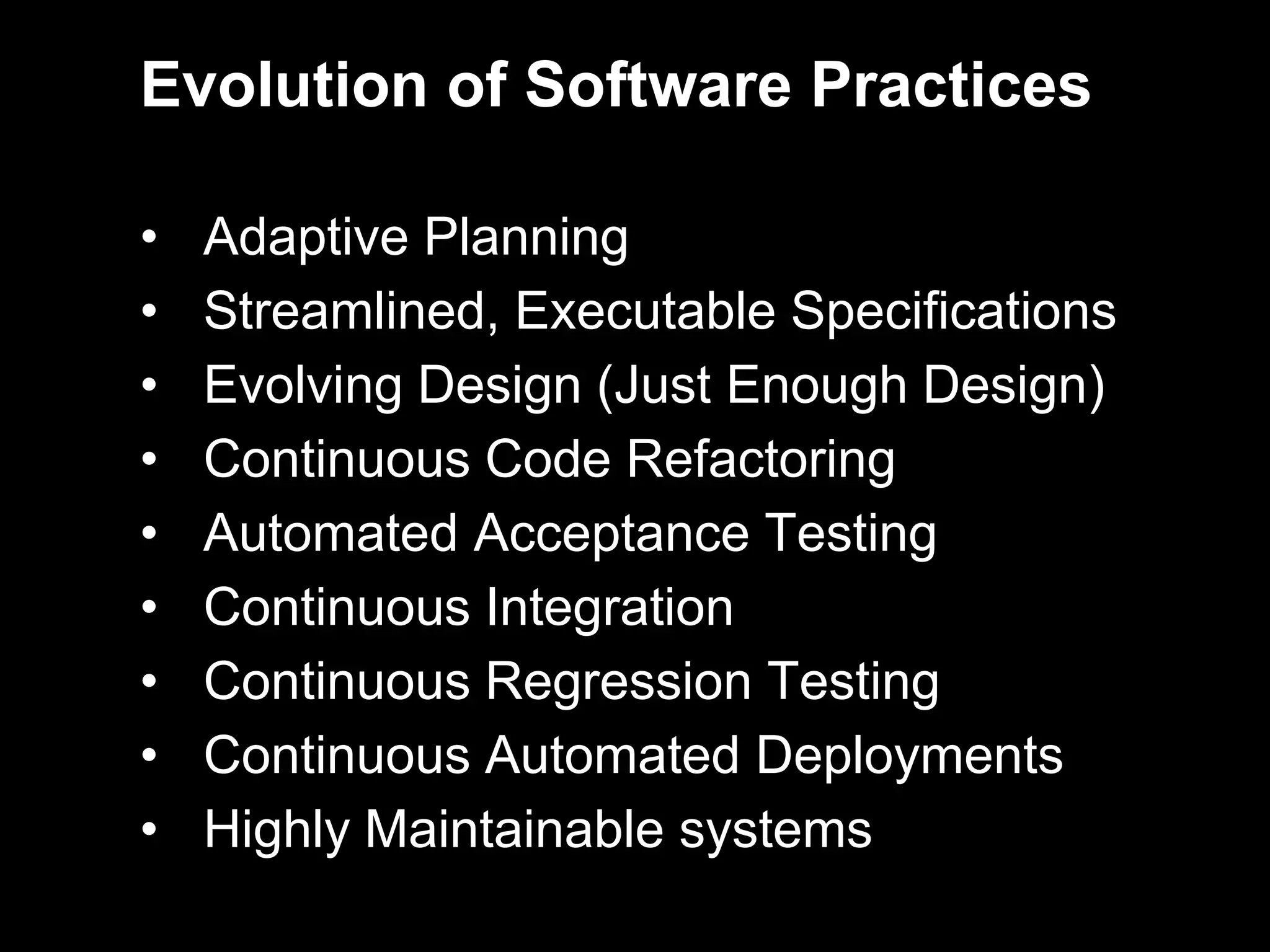

Evolution of Software Practices

•   Adaptive Planning
•   Streamlined, Executable Specifications
•   Evolving Design (Just Enough Design)
•   Continuous Code Refactoring
•   Automated Acceptance Testing
•   Continuous Integration
•   Continuous Regression Testing
•   Continuous Automated Deployments
•   Highly Maintainable systems
BDD – Behavior Driven Development

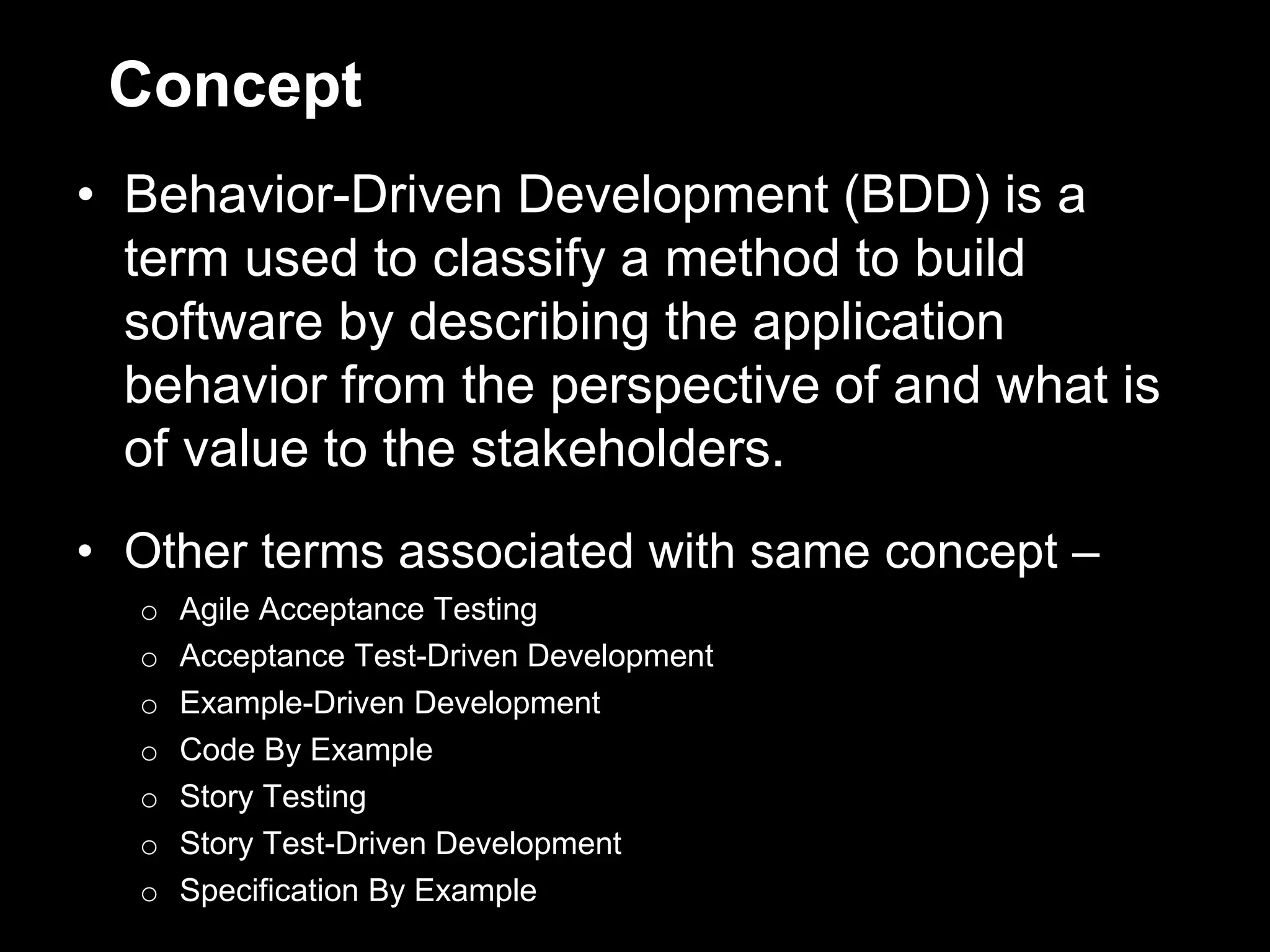

Concept
• Behavior-Driven Development (BDD) is a
  term used to classify a method to build
  software by describing the application
  behavior from the perspective of and what is
  of value to the stakeholders.
• Other terms associated with same concept –
  o   Agile Acceptance Testing
  o   Acceptance Test-Driven Development
  o   Example-Driven Development
  o   Code By Example
  o   Story Testing
  o   Story Test-Driven Development
  o   Specification By Example

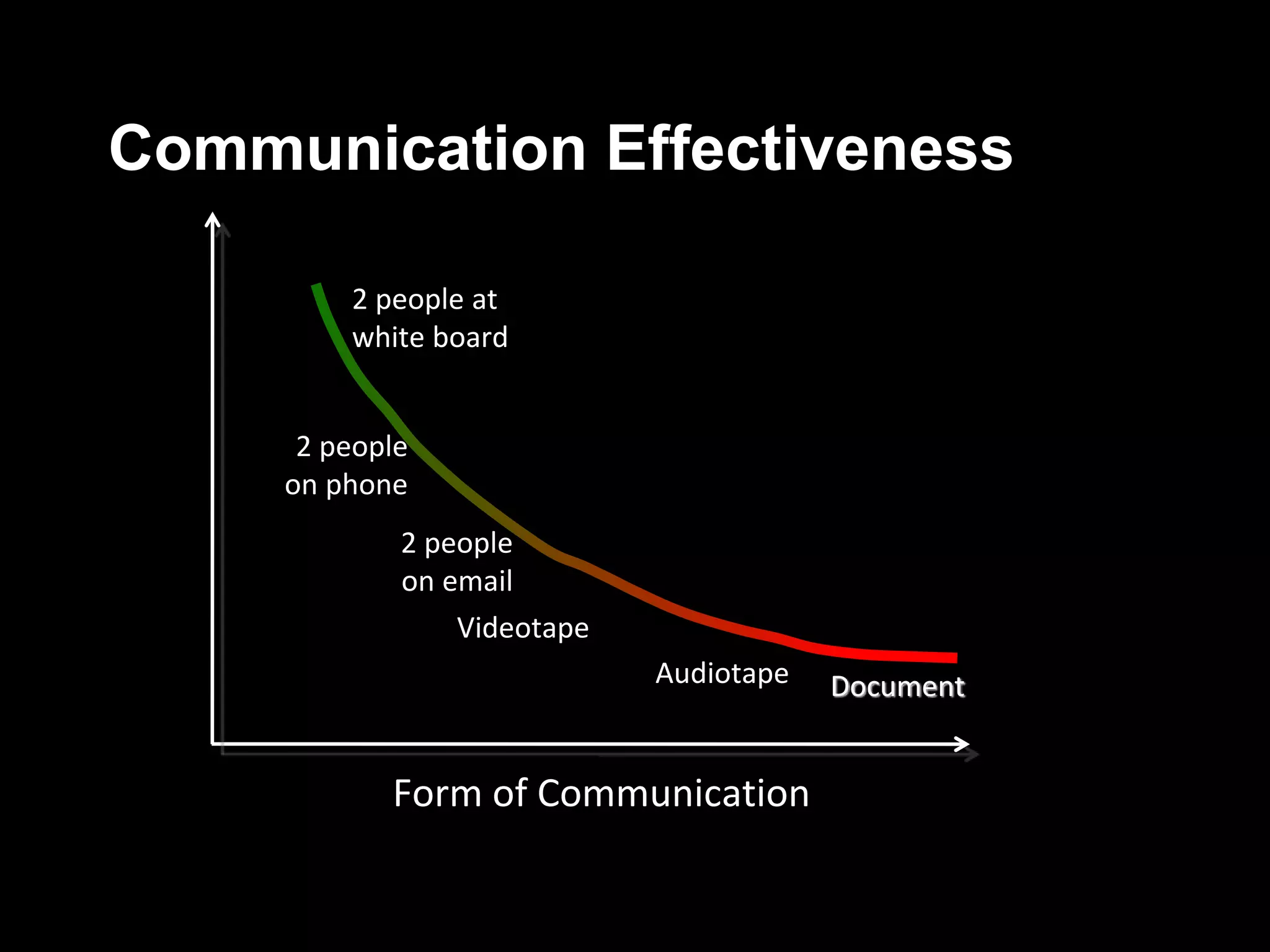

Communication Effectiveness

         2 people at
         white board

      2 people
     on phone
             2 people
             on email
                 Videotape
                             Audiotape   Document

            Form of Communication

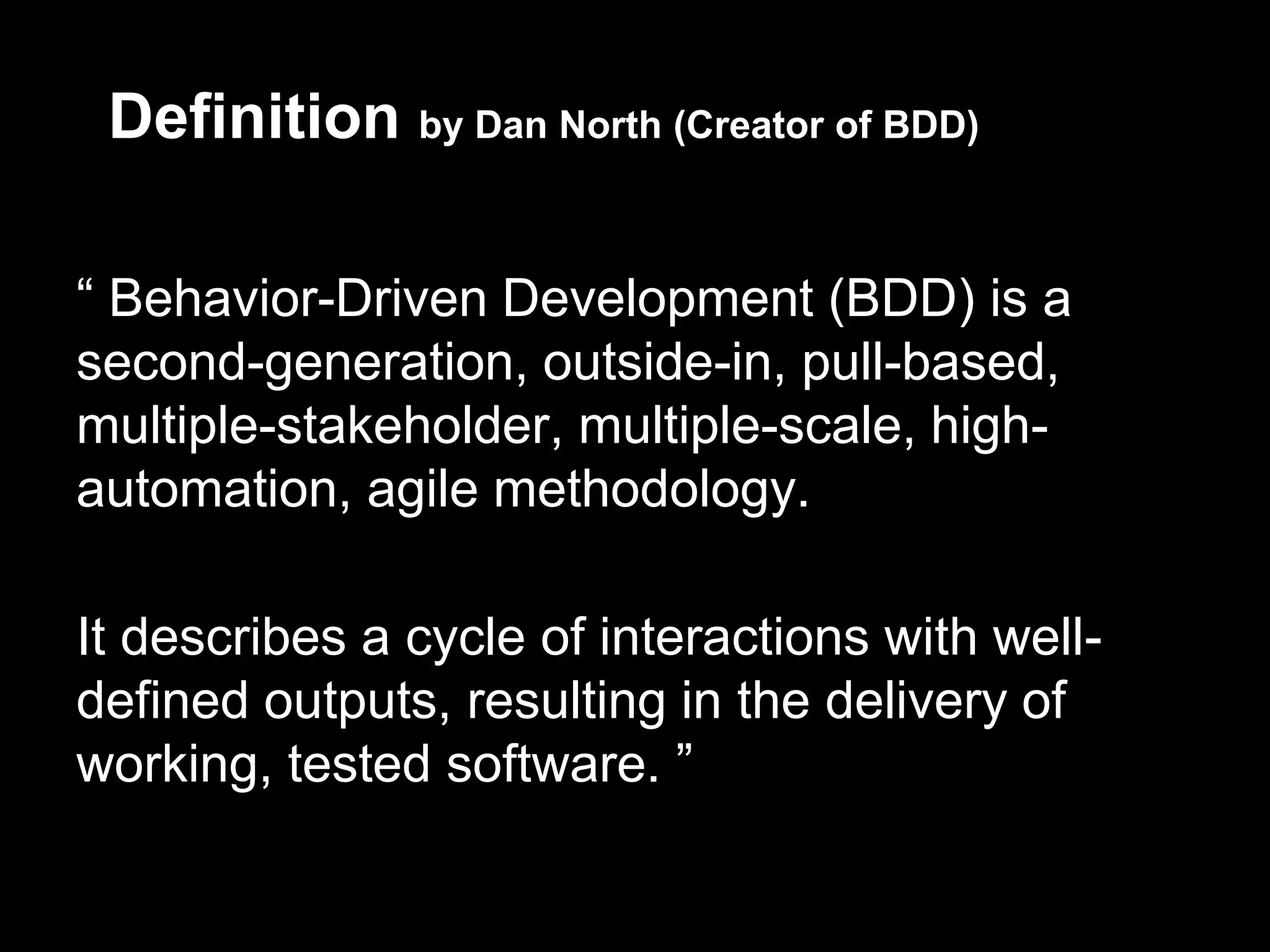

Definition by Dan North (Creator of BDD)

“ Behavior-Driven Development (BDD) is a
second-generation, outside-in, pull-based,
multiple-stakeholder, multiple-scale, high-
automation, agile methodology.

It describes a cycle of interactions with well-
defined outputs, resulting in the delivery of
working, tested software. ”

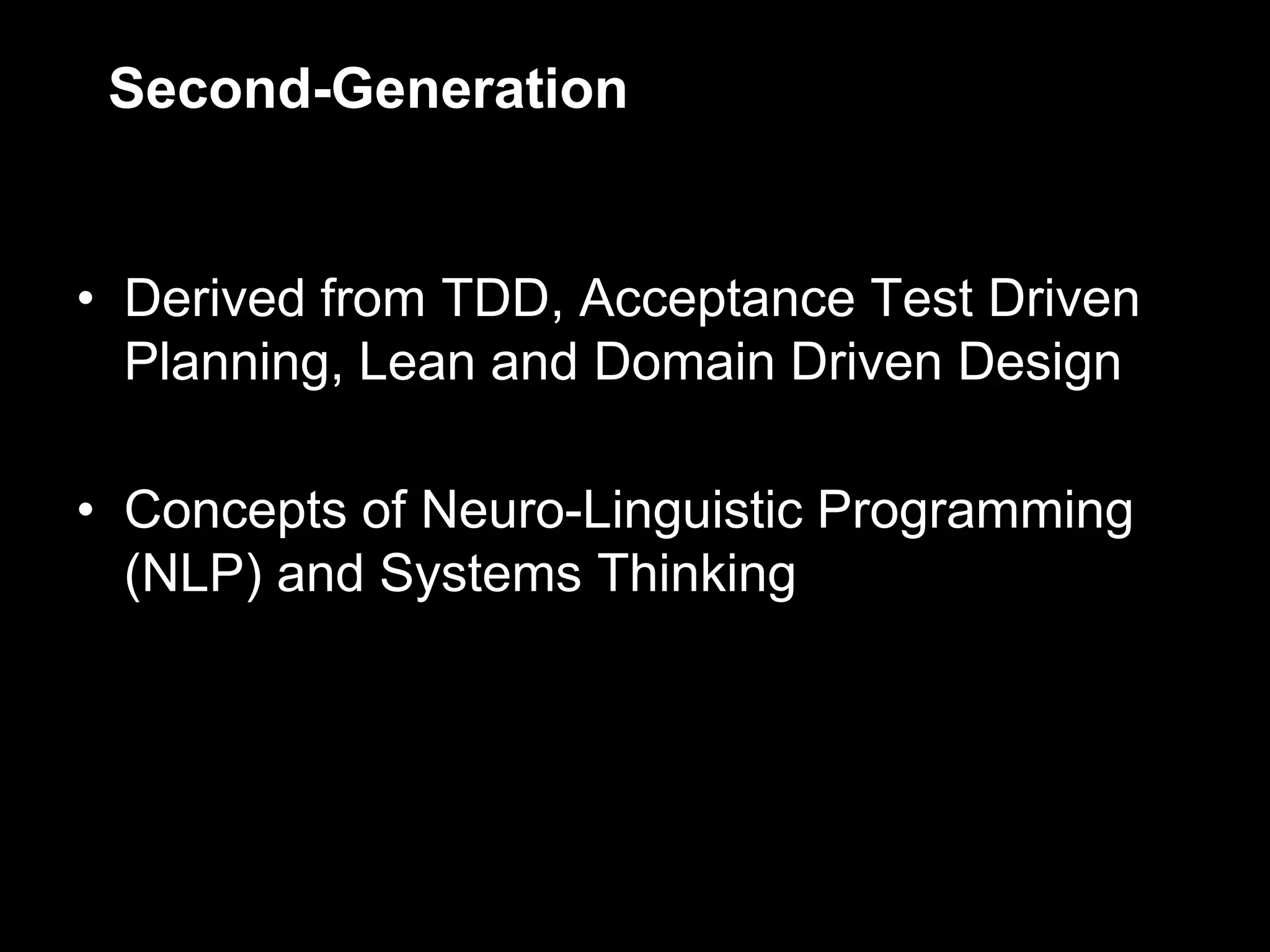

Second-Generation

• Derived from TDD, Acceptance Test Driven
  Planning, Lean and Domain Driven Design

• Concepts of Neuro-Linguistic Programming
  (NLP) and Systems Thinking

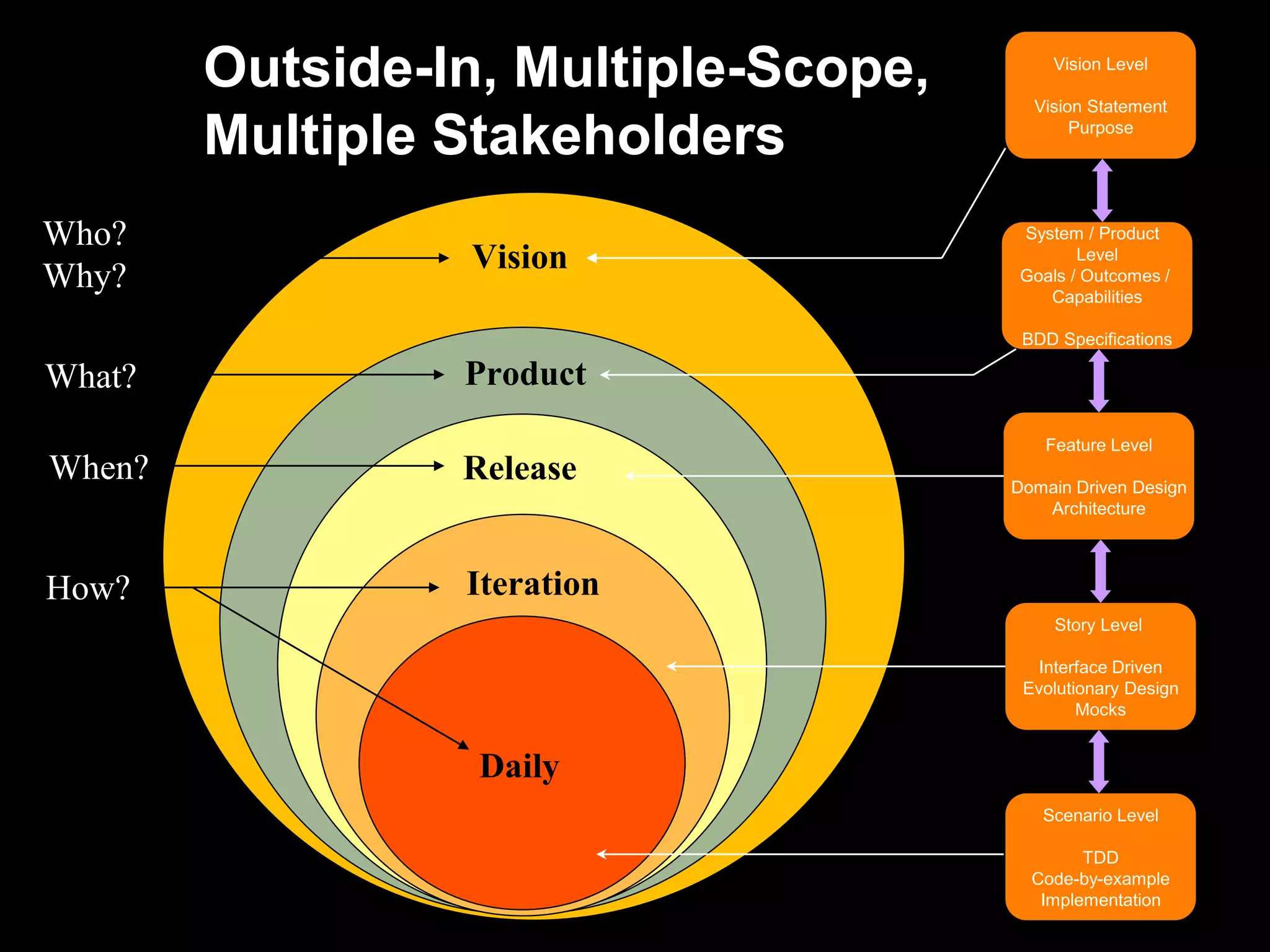

Outside-In, Multiple-Scope,        Vision Level

                                        Vision Statement

        Multiple Stakeholders                Purpose

Who?                                   System / Product
                 Vision                       Level
Why?                                   Goals / Outcomes /
                                          Capabilities

                                       BDD Specifications

What?            Product
                                          Feature Level
When?            Release              Domain Driven Design
                                         Architecture

How?             Iteration
                                           Story Level

                                         Interface Driven
                                       Evolutionary Design
                                              Mocks

                  Daily
                                         Scenario Level

                                              TDD
                                        Code-by-example
                                         Implementation

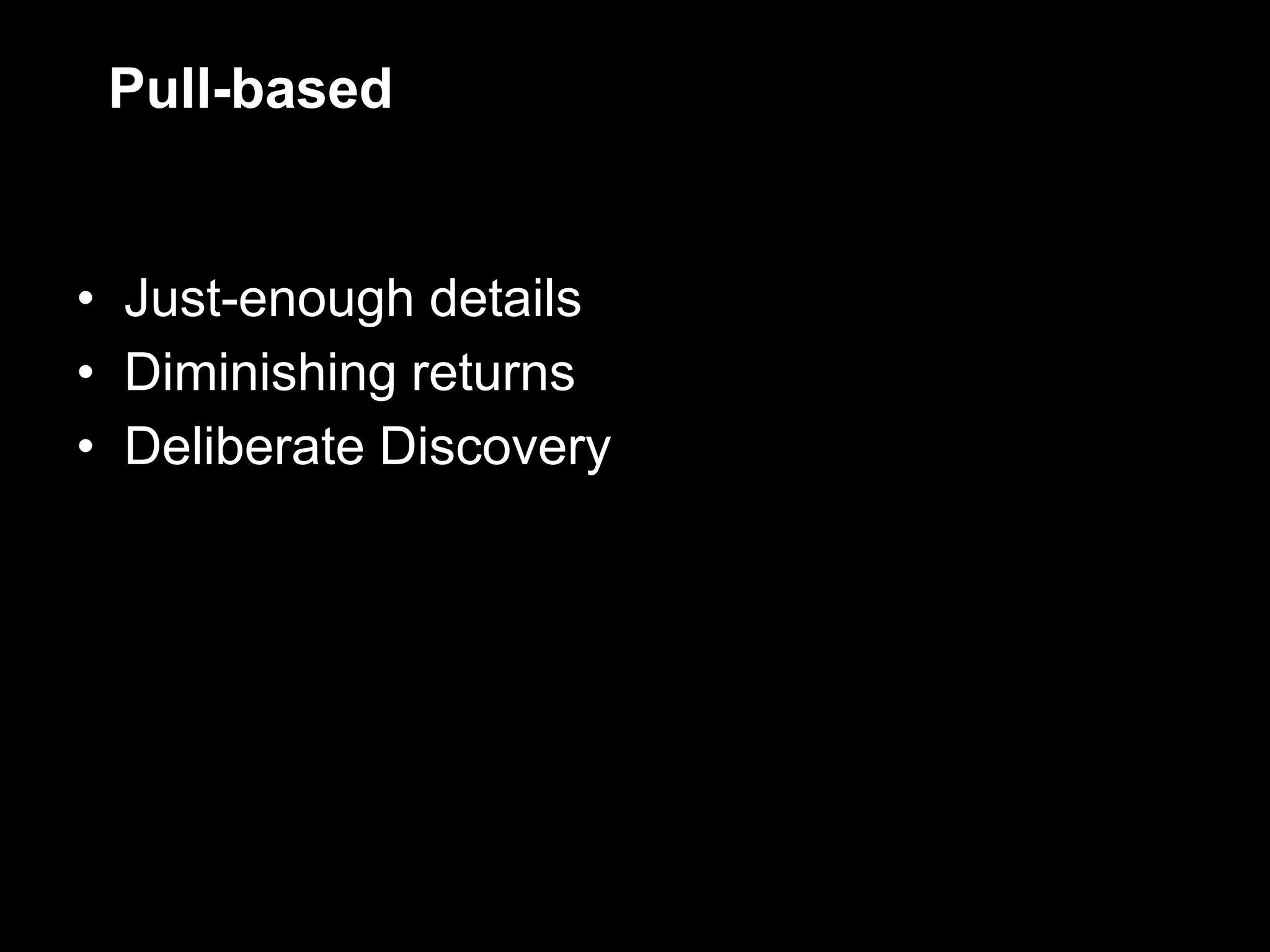

Pull-based

• Just-enough details
• Diminishing returns
• Deliberate Discovery

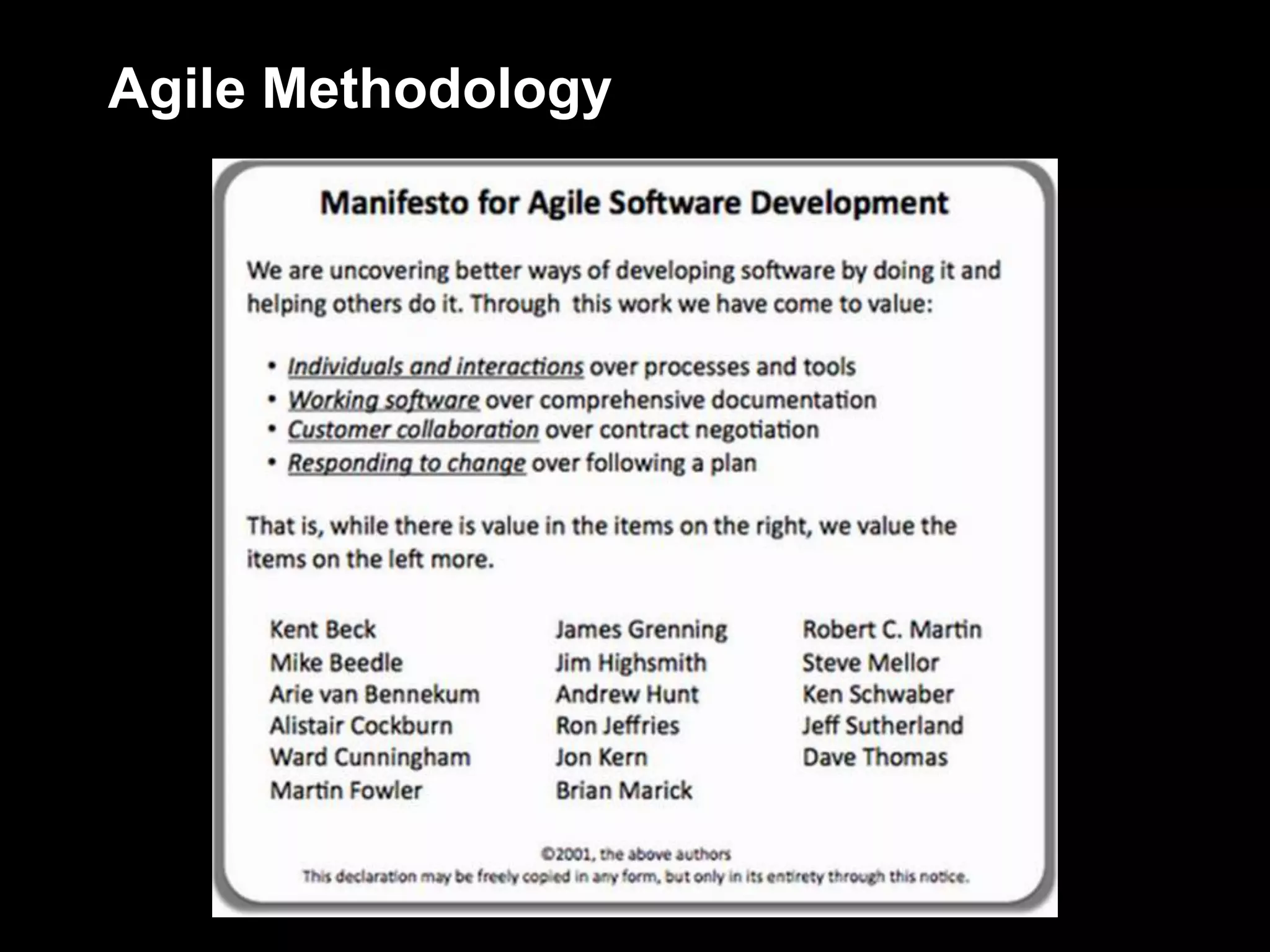

Agile Methodology

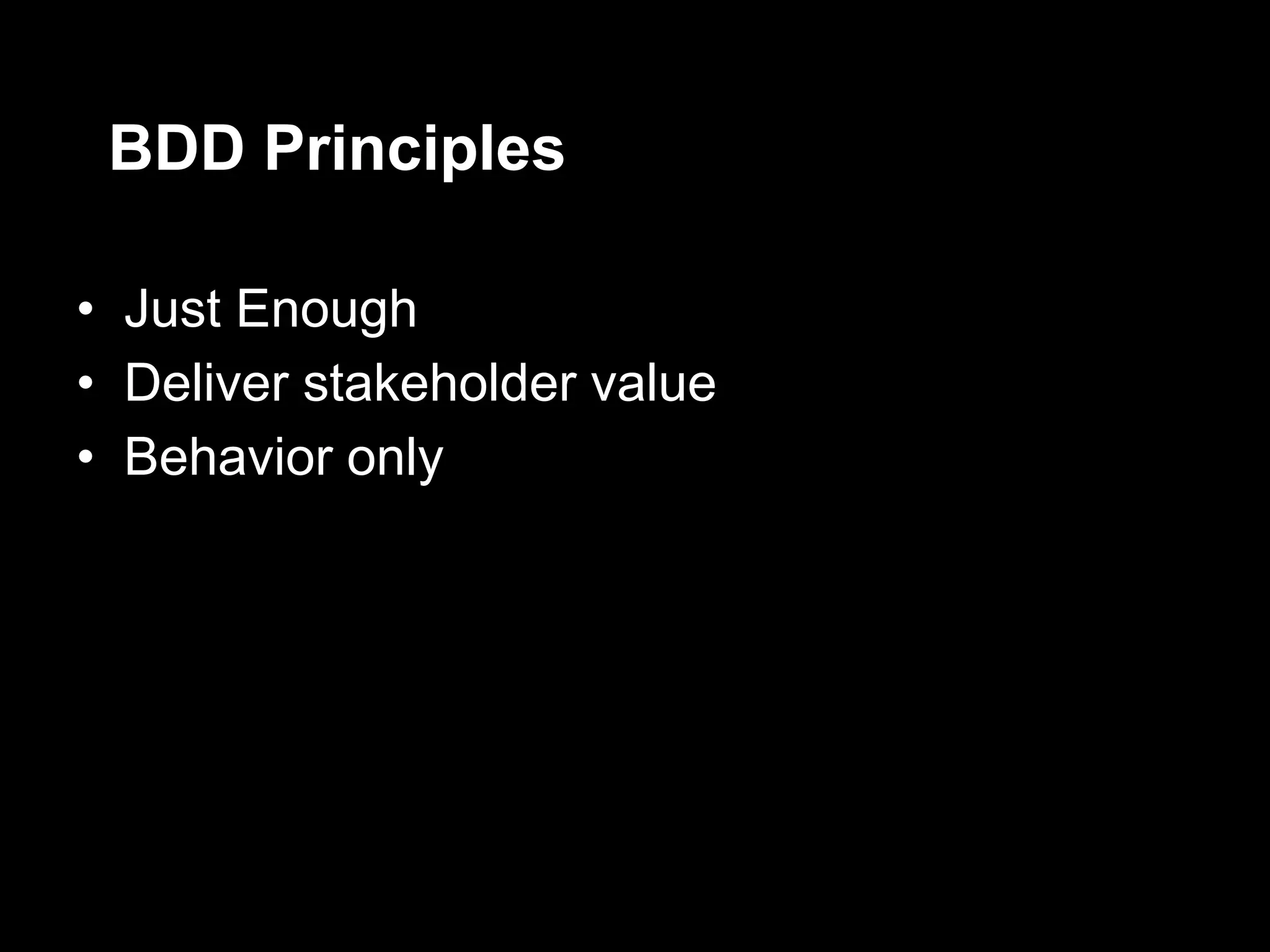

BDD Principles

• Just Enough
• Deliver stakeholder value
• Behavior only

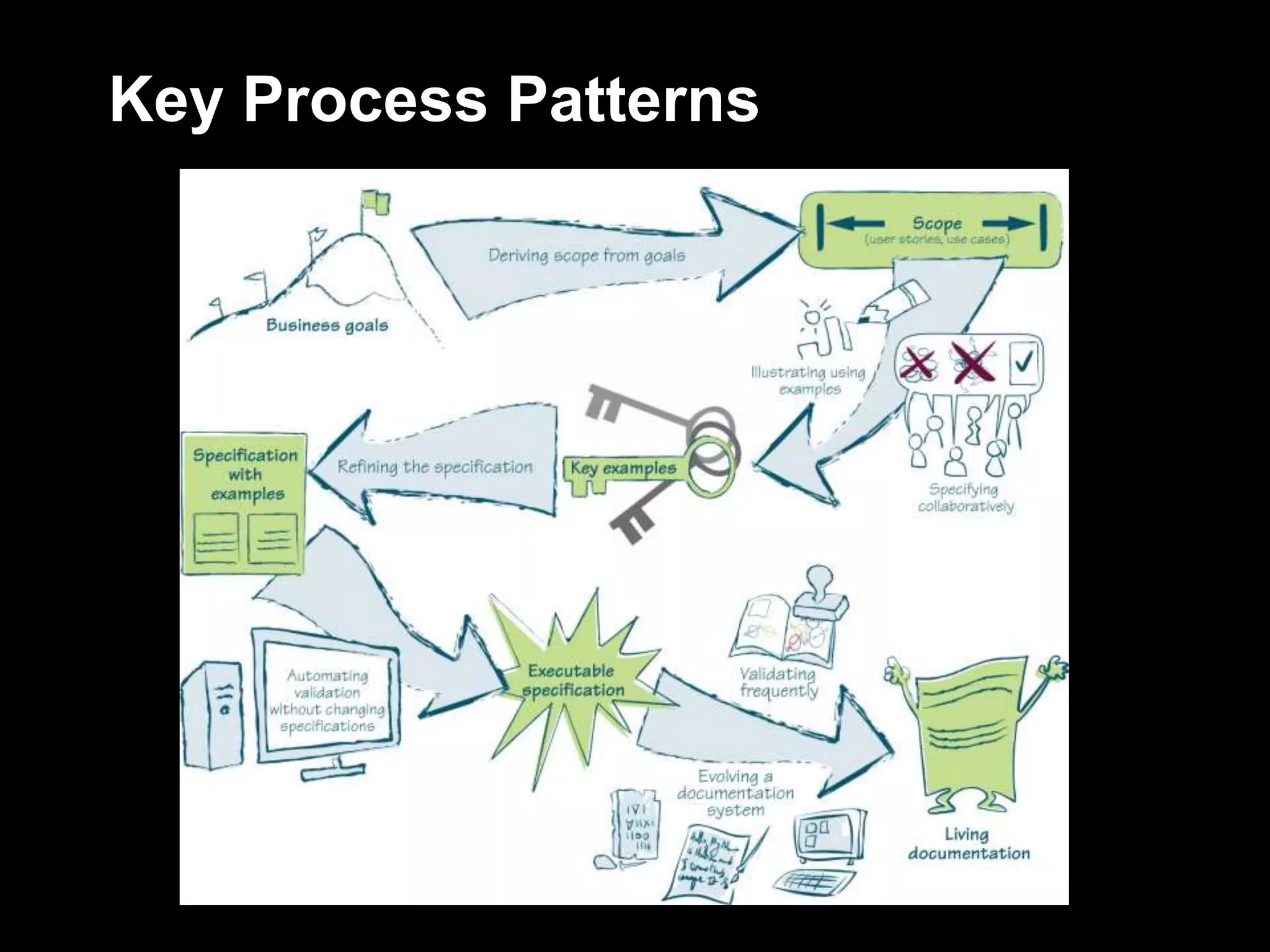

Key Process Patterns

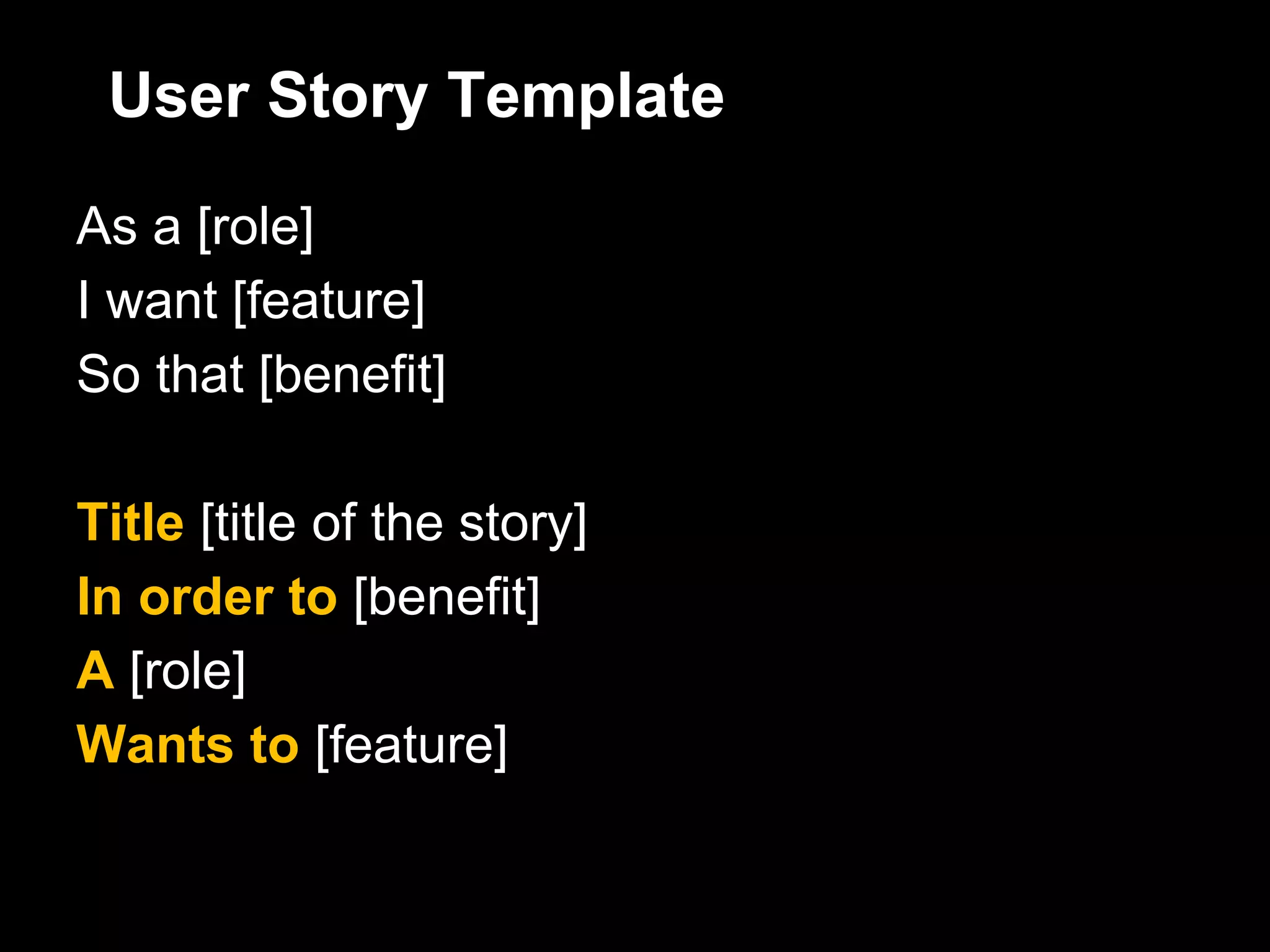

User Story Template

As a [role]
I want [feature]
So that [benefit]

Title [title of the story]
In order to [benefit]
A [role]
Wants to [feature]
User Story Example

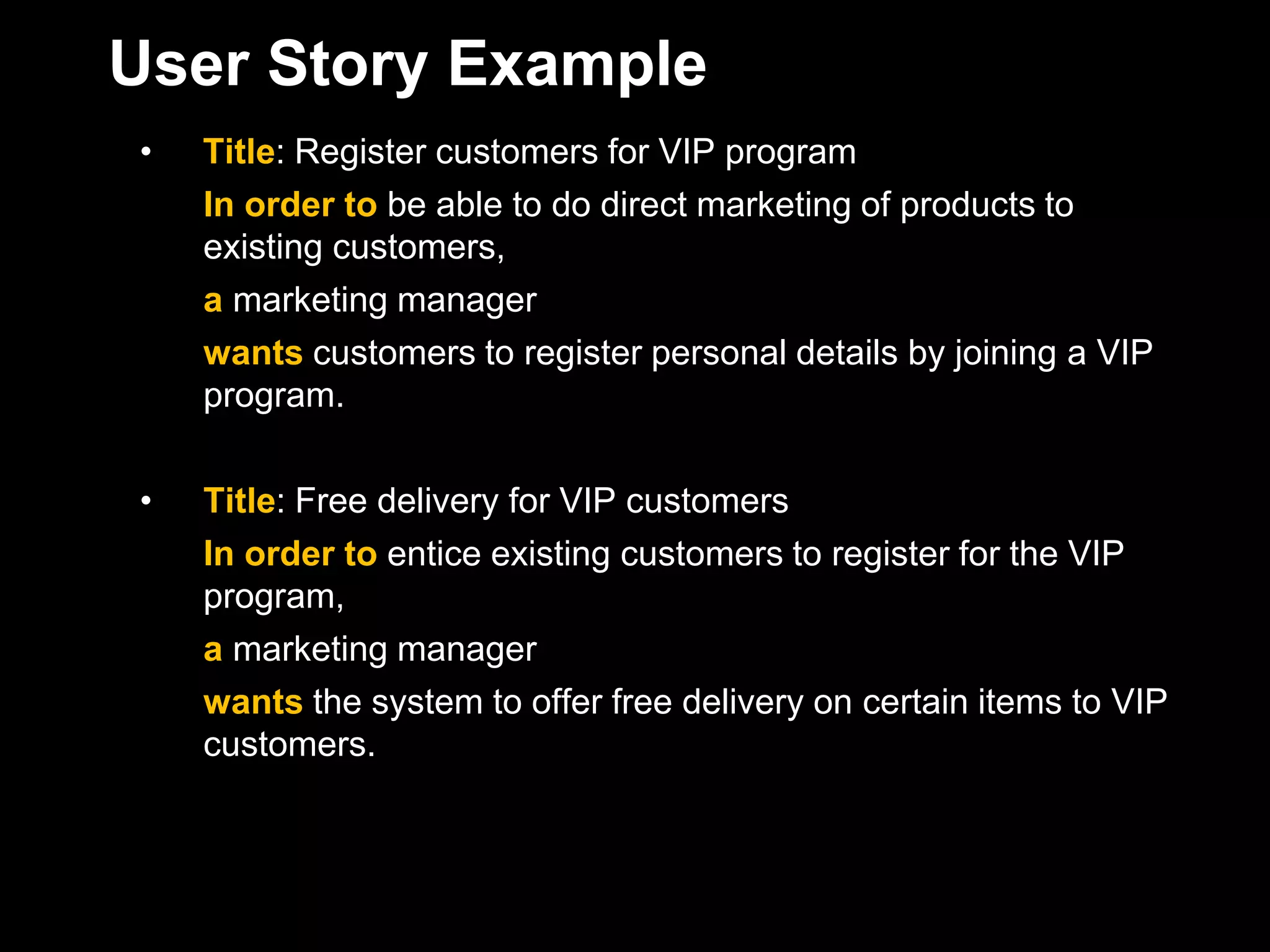

•   Title: Register customers for VIP program
    In order to be able to do direct marketing of products to
    existing customers,
    a marketing manager
    wants customers to register personal details by joining a VIP
    program.

•   Title: Free delivery for VIP customers
    In order to entice existing customers to register for the VIP
    program,
    a marketing manager
    wants the system to offer free delivery on certain items to VIP
    customers.

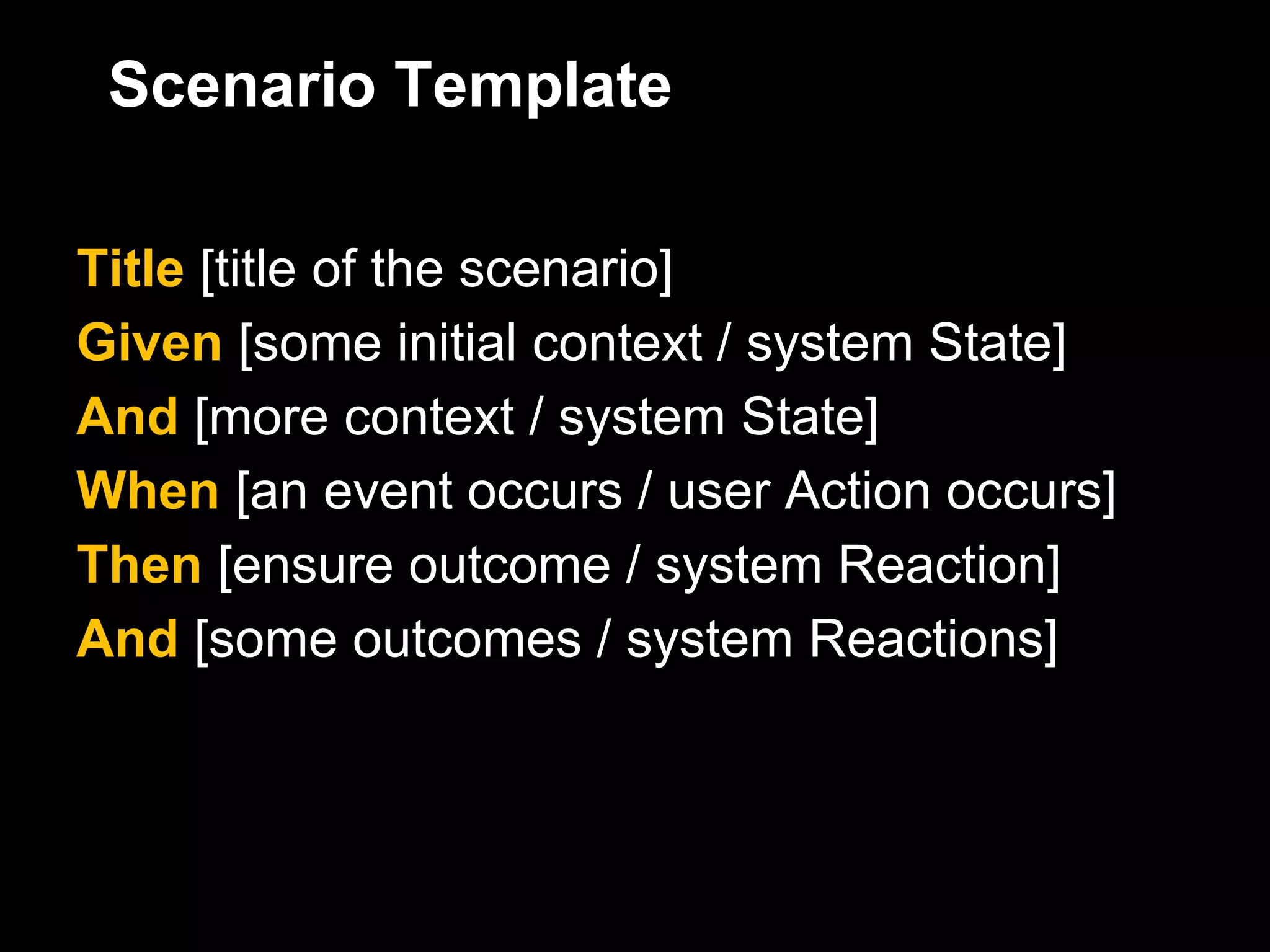

Scenario Template

Title [title of the scenario]
Given [some initial context / system State]
And [more context / system State]
When [an event occurs / user Action occurs]
Then [ensure outcome / system Reaction]
And [some outcomes / system Reactions]

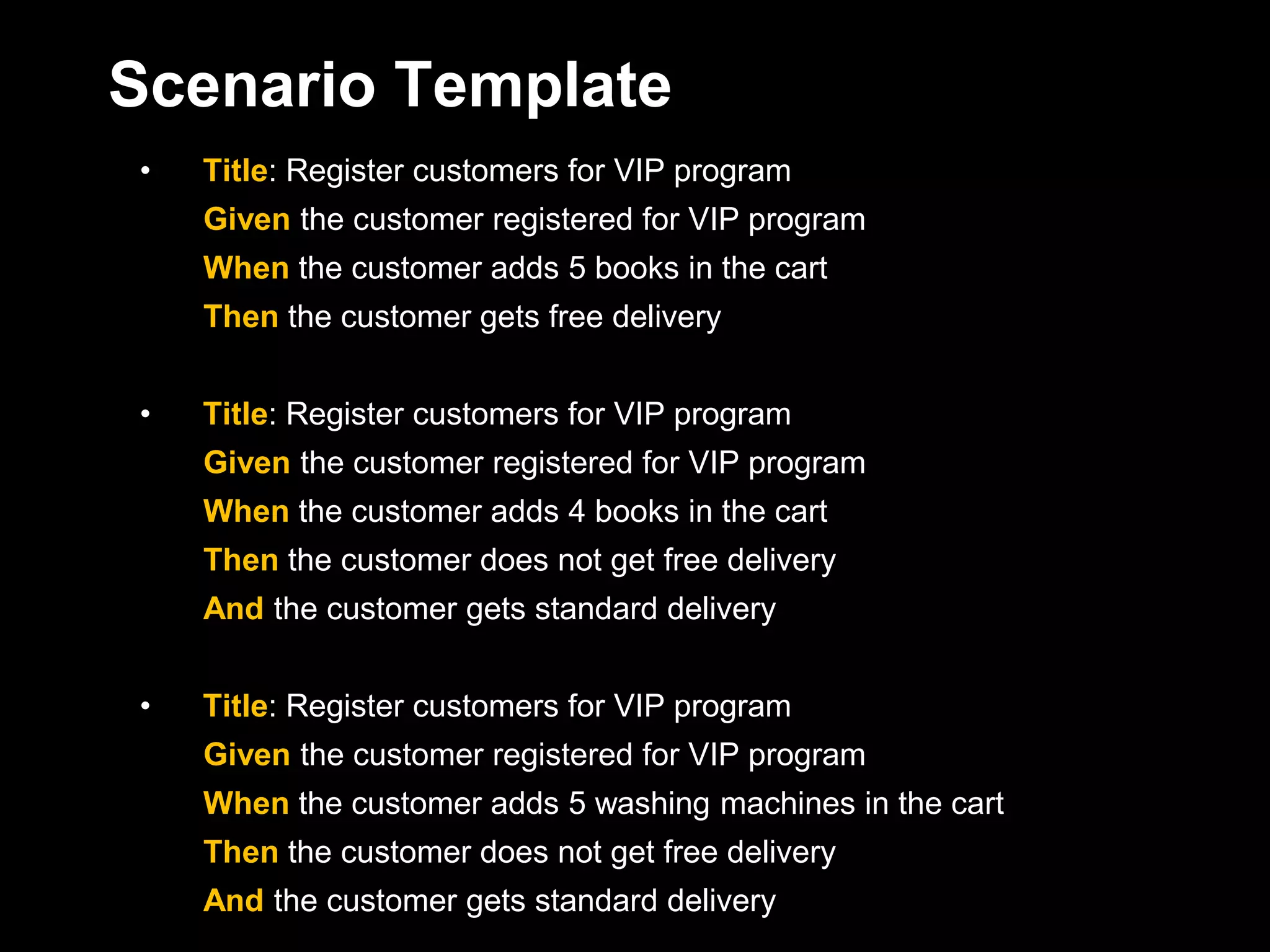

Scenario Template
•   Title: Register customers for VIP program
    Given the customer registered for VIP program
    When the customer adds 5 books in the cart
    Then the customer gets free delivery

•   Title: Register customers for VIP program
    Given the customer registered for VIP program
    When the customer adds 4 books in the cart
    Then the customer does not get free delivery
    And the customer gets standard delivery

•   Title: Register customers for VIP program
    Given the customer registered for VIP program
    When the customer adds 5 washing machines in the cart
    Then the customer does not get free delivery
    And the customer gets standard delivery
User Story & Scenario Example

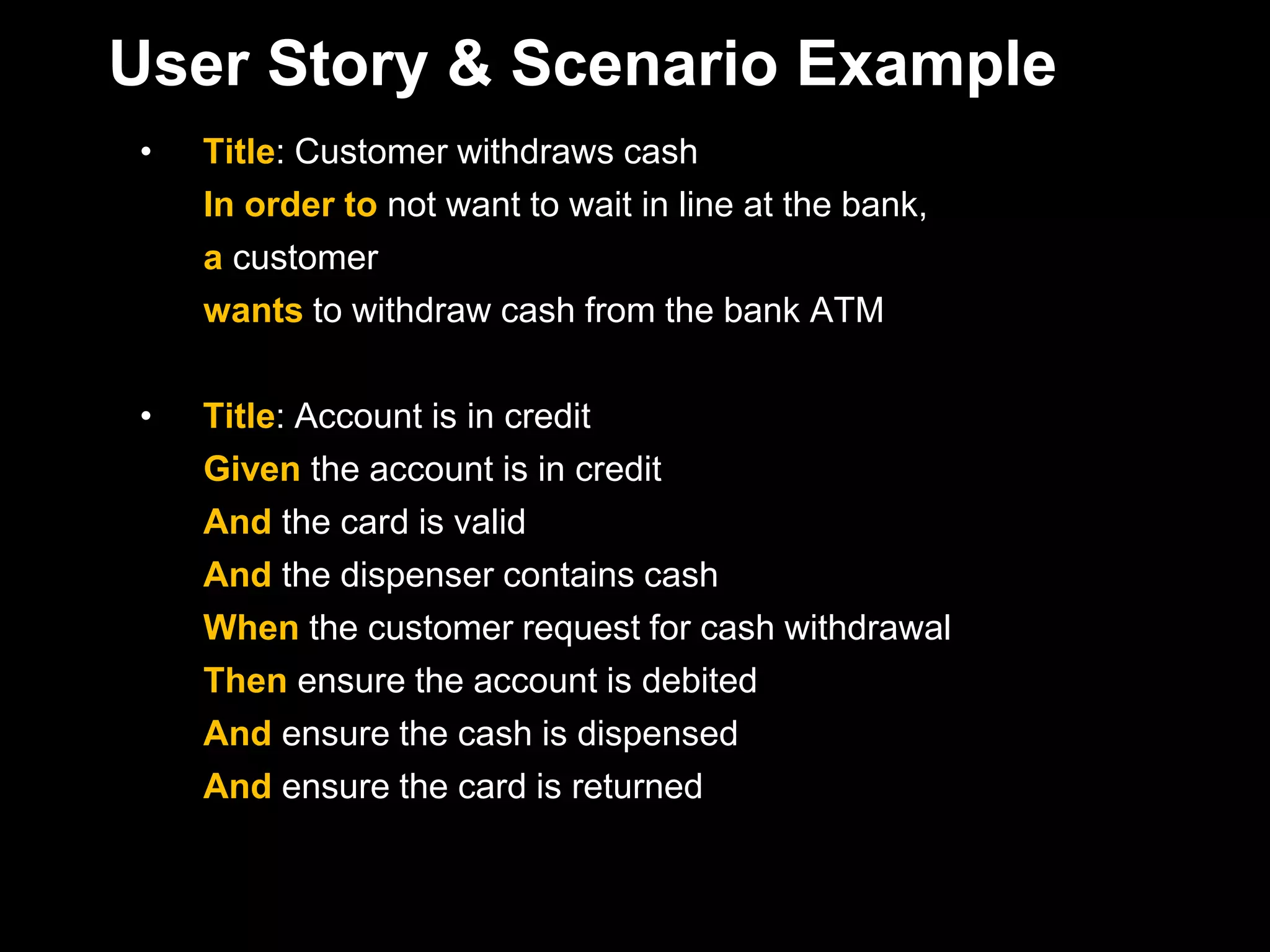

•   Title: Customer withdraws cash
    In order to not want to wait in line at the bank,
    a customer
    wants to withdraw cash from the bank ATM

•   Title: Account is in credit
    Given the account is in credit
    And the card is valid
    And the dispenser contains cash
    When the customer request for cash withdrawal
    Then ensure the account is debited
    And ensure the cash is dispensed
    And ensure the card is returned

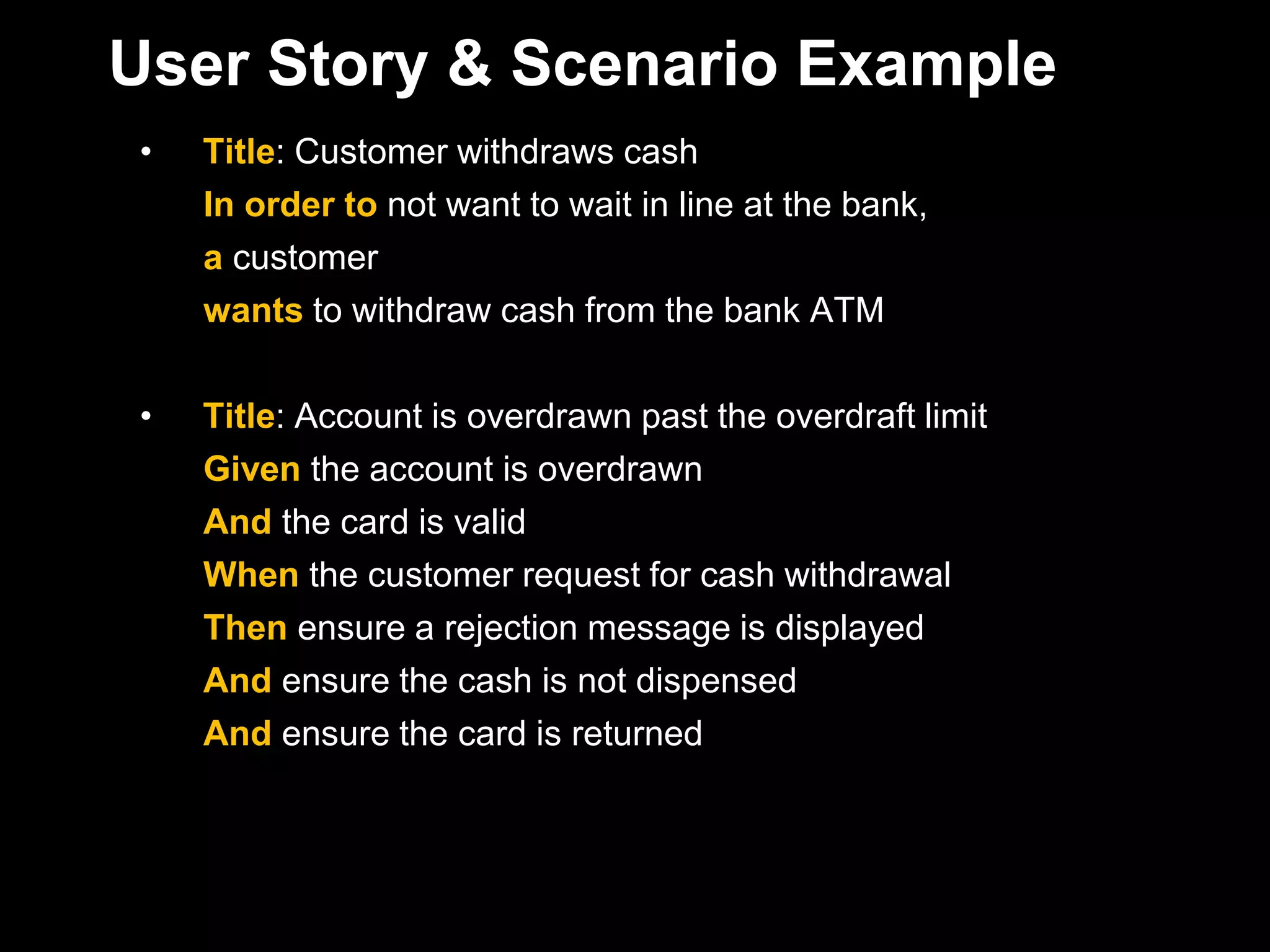

User Story & Scenario Example
•   Title: Customer withdraws cash
    In order to not want to wait in line at the bank,
    a customer
    wants to withdraw cash from the bank ATM

•   Title: Account is overdrawn past the overdraft limit
    Given the account is overdrawn
    And the card is valid
    When the customer request for cash withdrawal
    Then ensure a rejection message is displayed
    And ensure the cash is not dispensed
    And ensure the card is returned

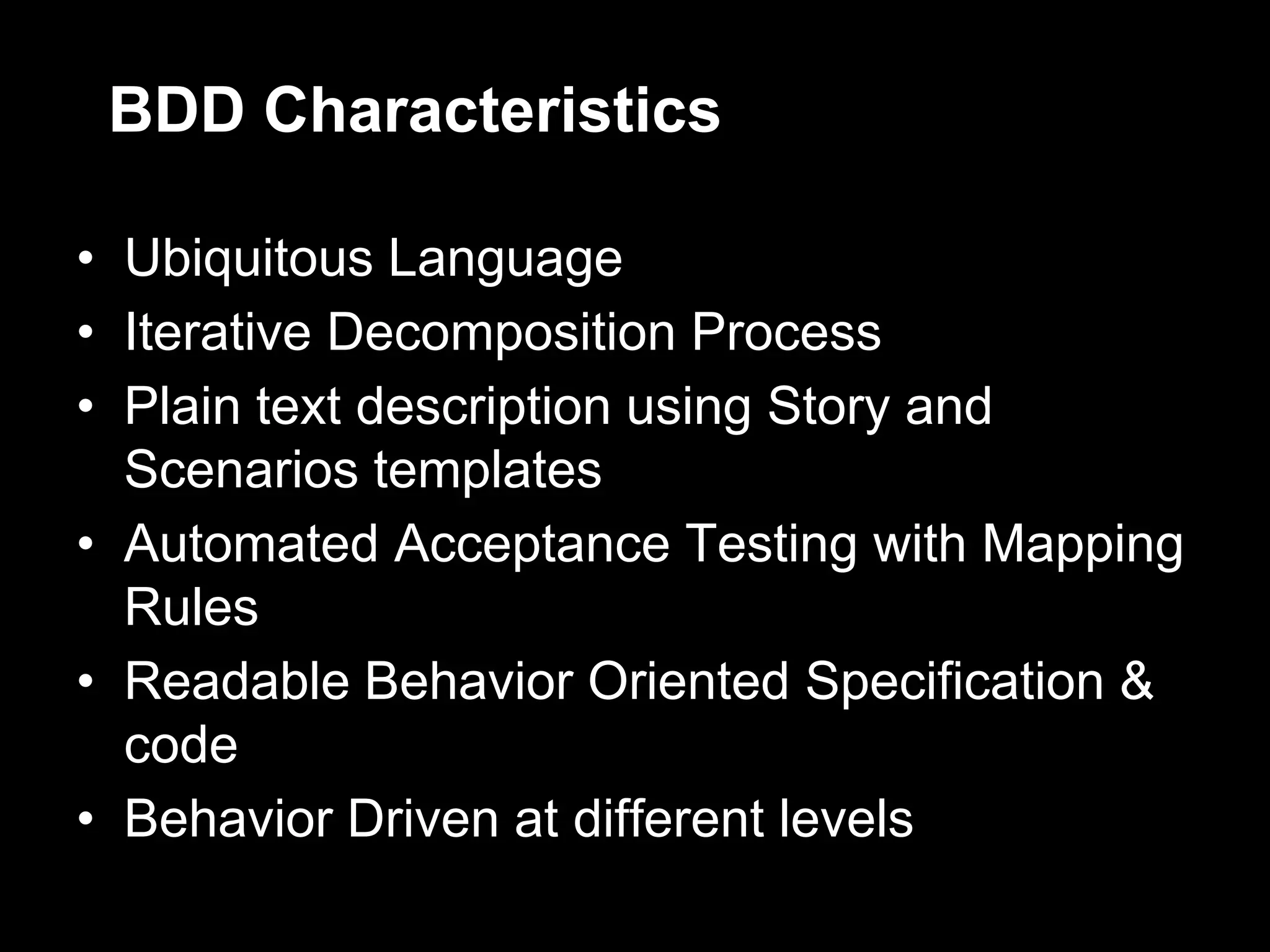

BDD Characteristics

• Ubiquitous Language
• Iterative Decomposition Process
• Plain text description using Story and
  Scenarios templates
• Automated Acceptance Testing with Mapping
  Rules
• Readable Behavior Oriented Specification &
  code
• Behavior Driven at different levels

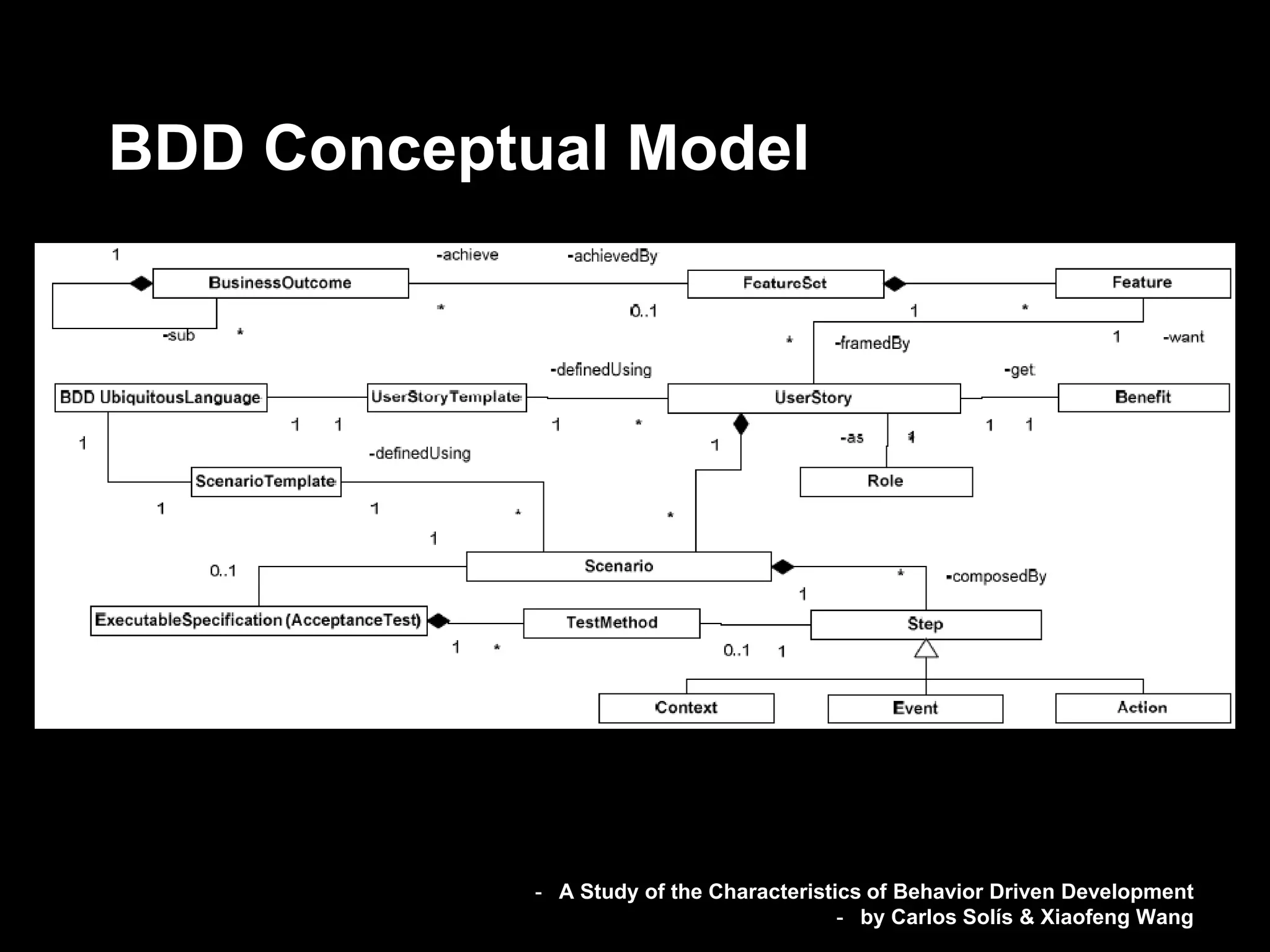

BDD Conceptual Model

            - A Study of the Characteristics of Behavior Driven Development
                                          - by Carlos Solís & Xiaofeng Wang

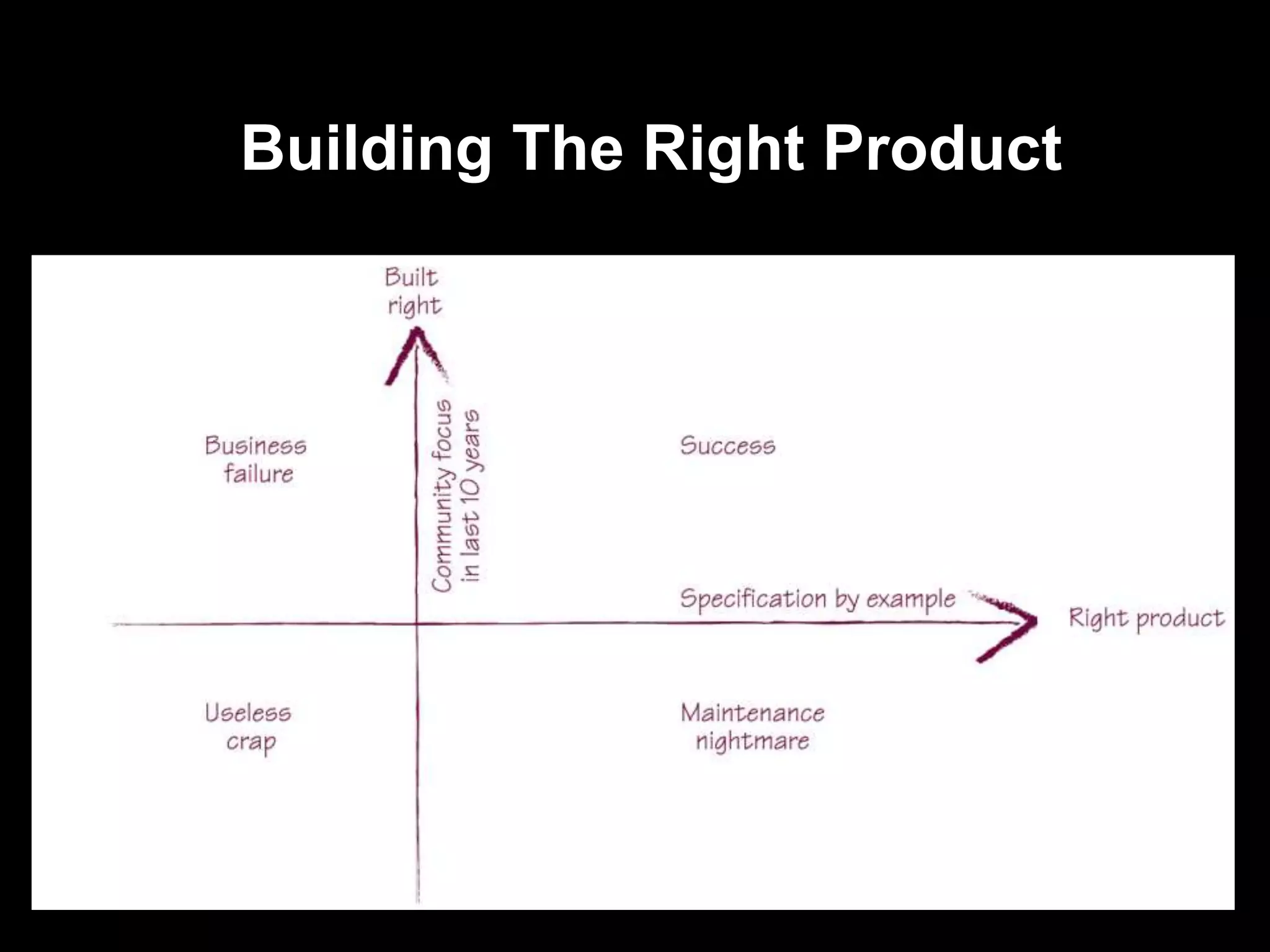

Building The Right Product

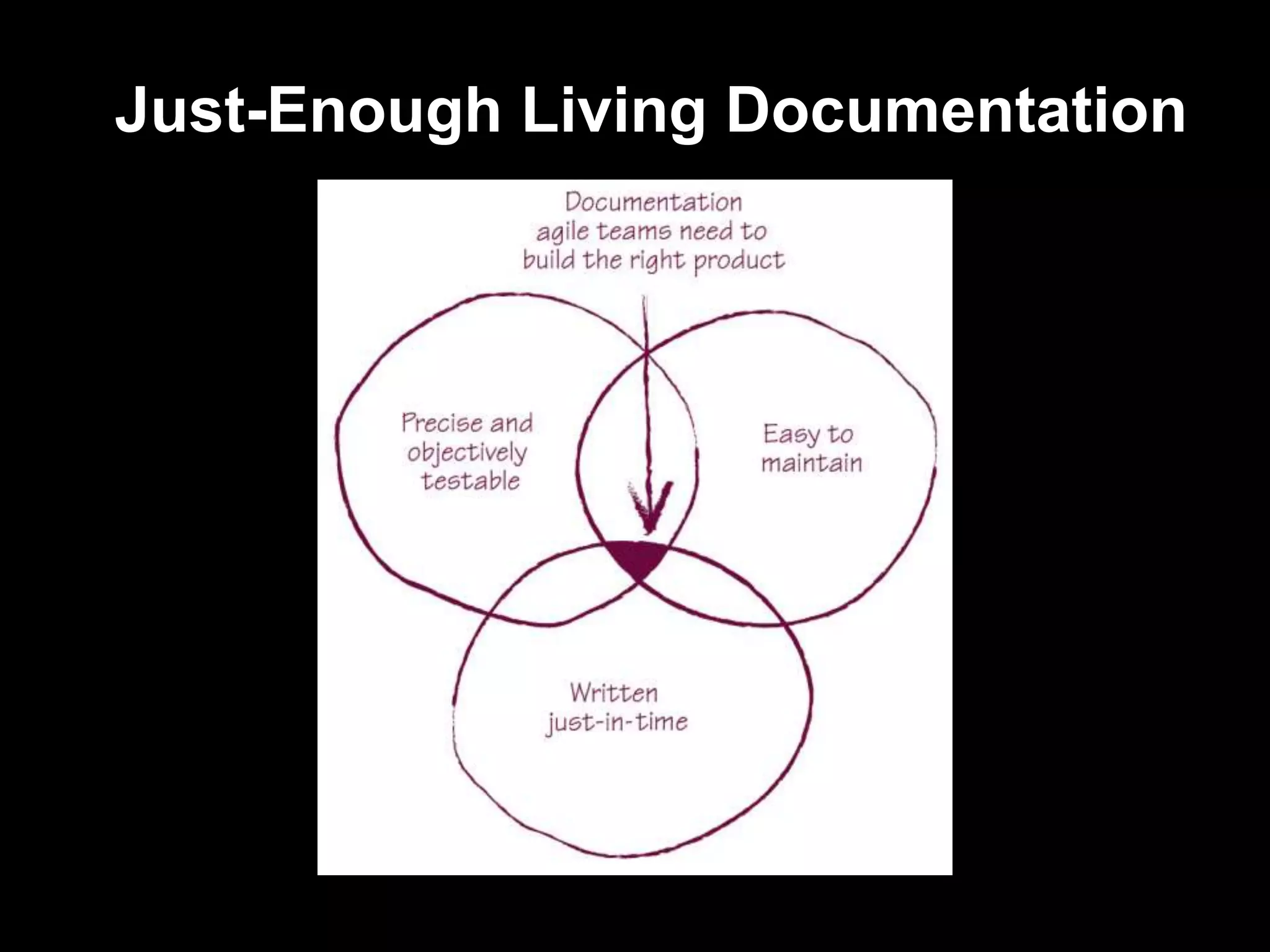

Just-Enough Living Documentation

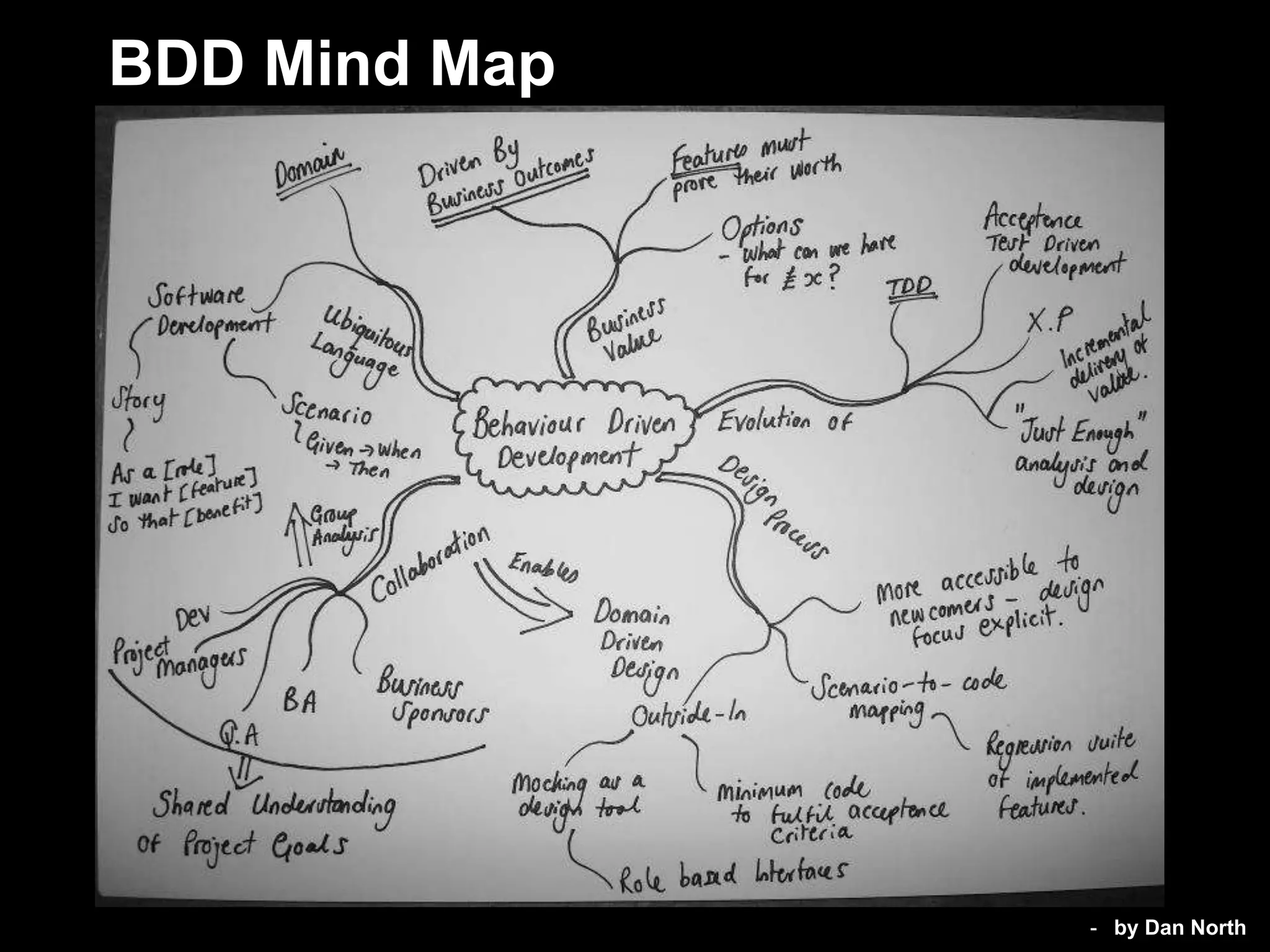

BDD Mind Map

               - by Dan North

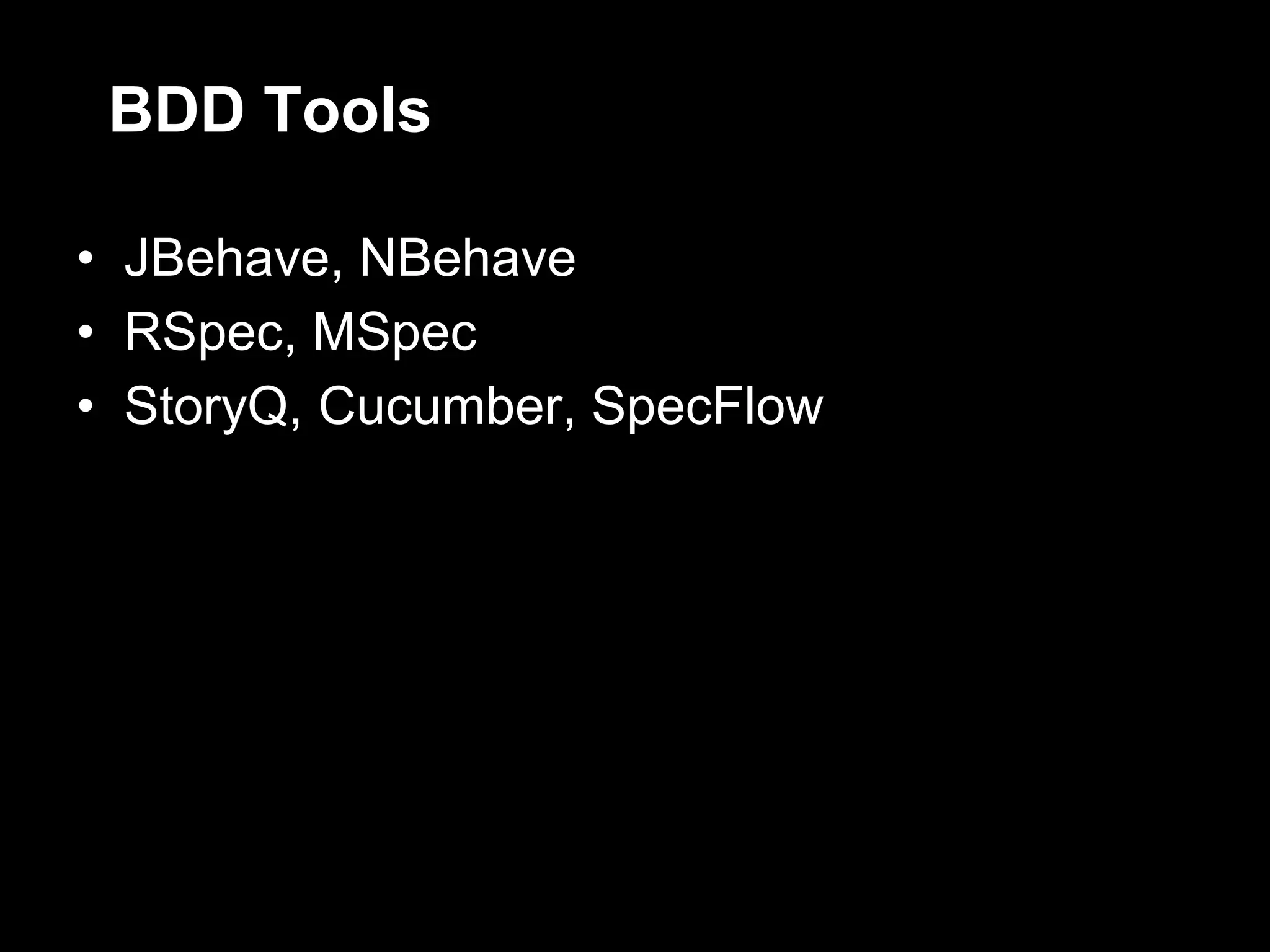

BDD Tools

• JBehave, NBehave
• RSpec, MSpec
• StoryQ, Cucumber, SpecFlow

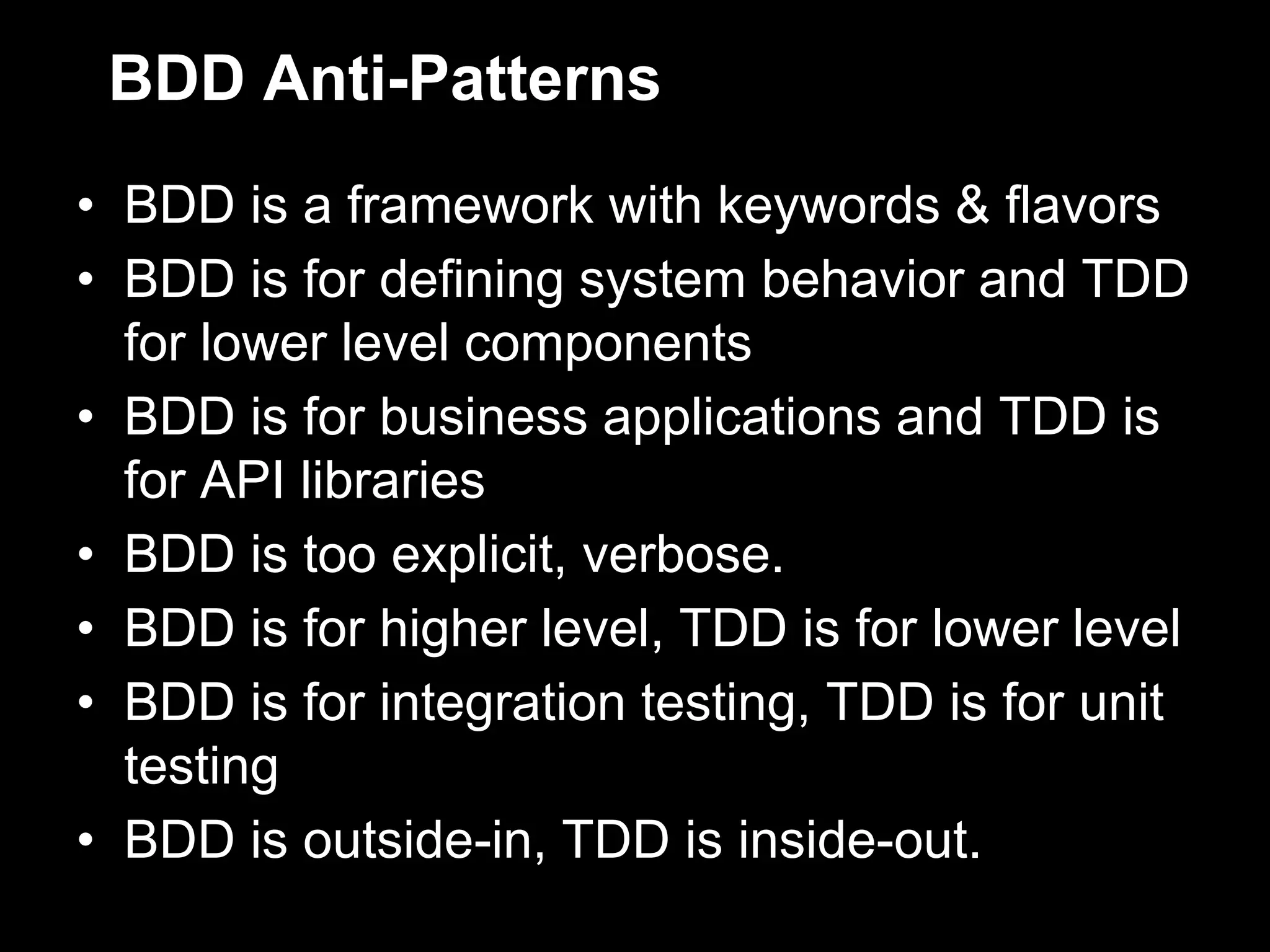

BDD Anti-Patterns
• BDD is a framework with keywords & flavors
• BDD is for defining system behavior and TDD
  for lower level components
• BDD is for business applications and TDD is
  for API libraries
• BDD is too explicit, verbose.
• BDD is for higher level, TDD is for lower level
• BDD is for integration testing, TDD is for unit
  testing
• BDD is outside-in, TDD is inside-out.

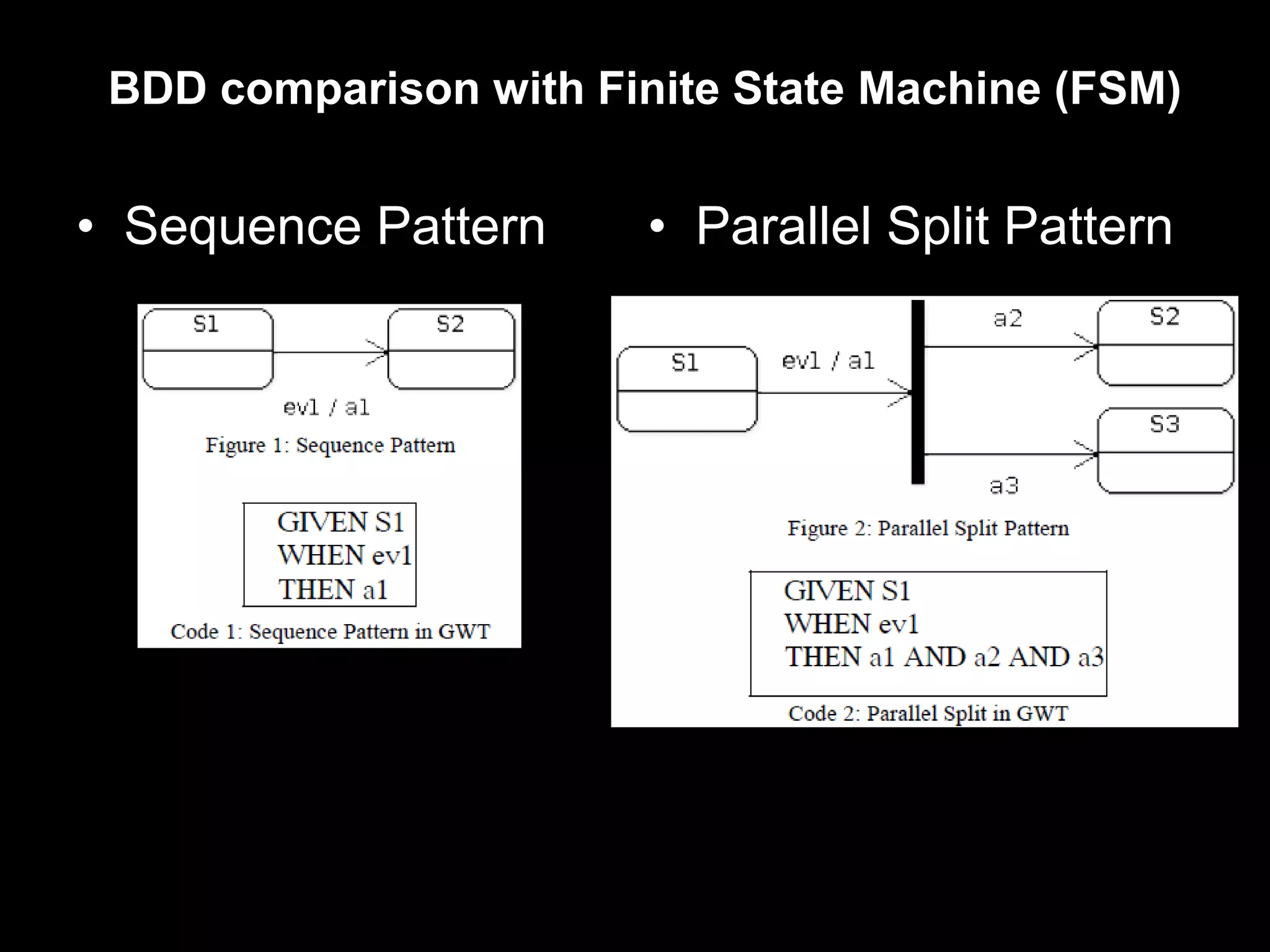

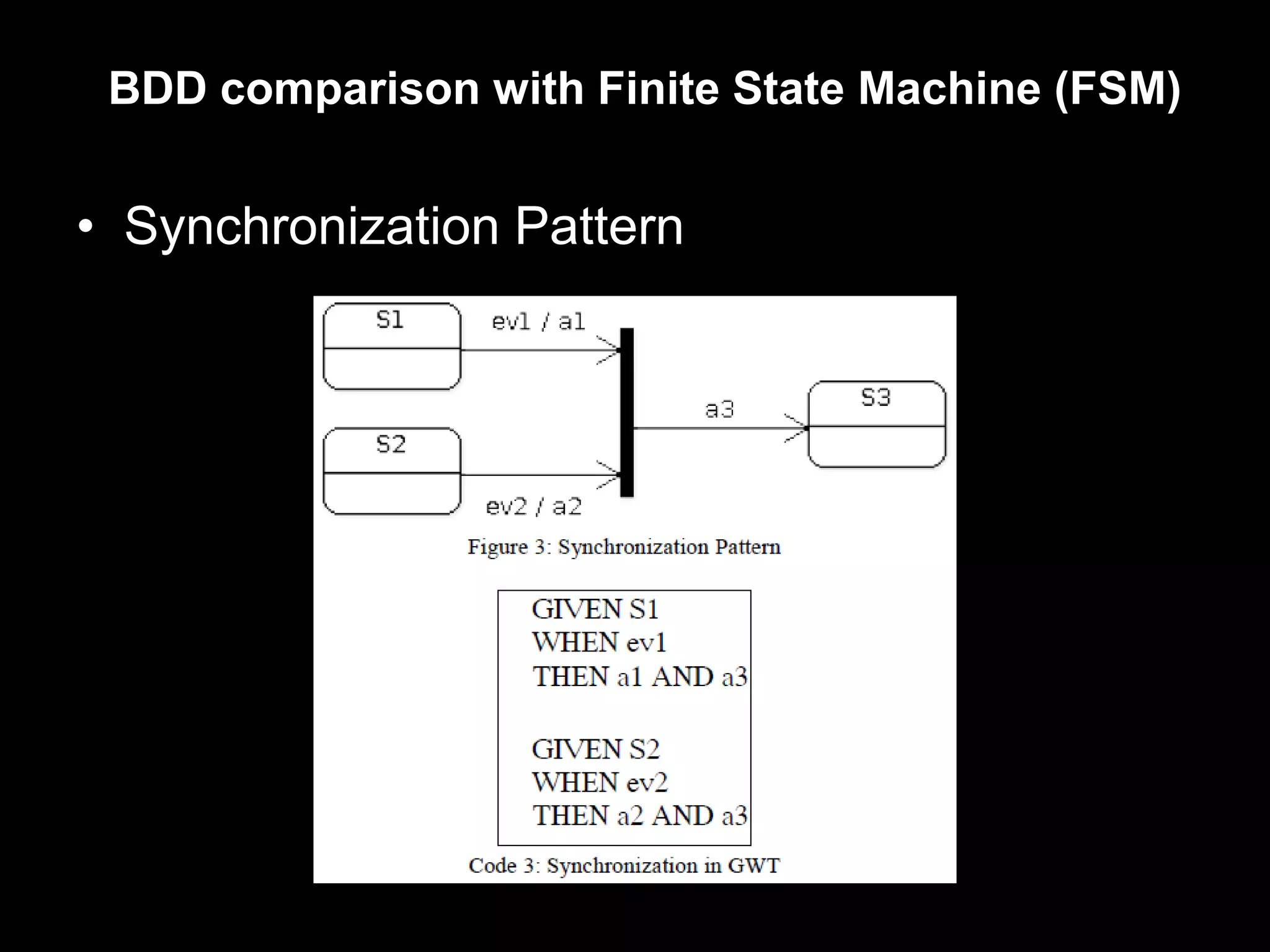

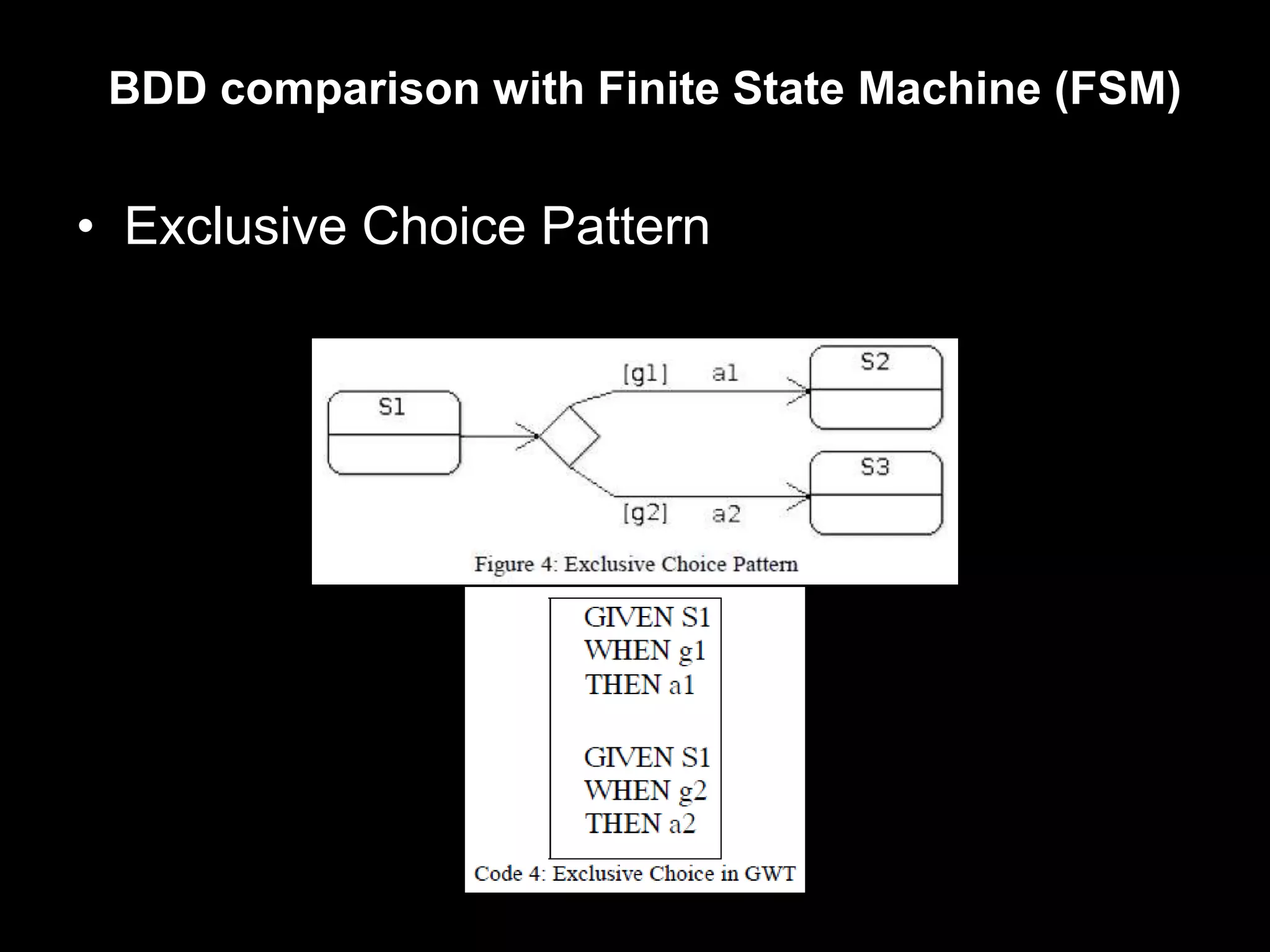

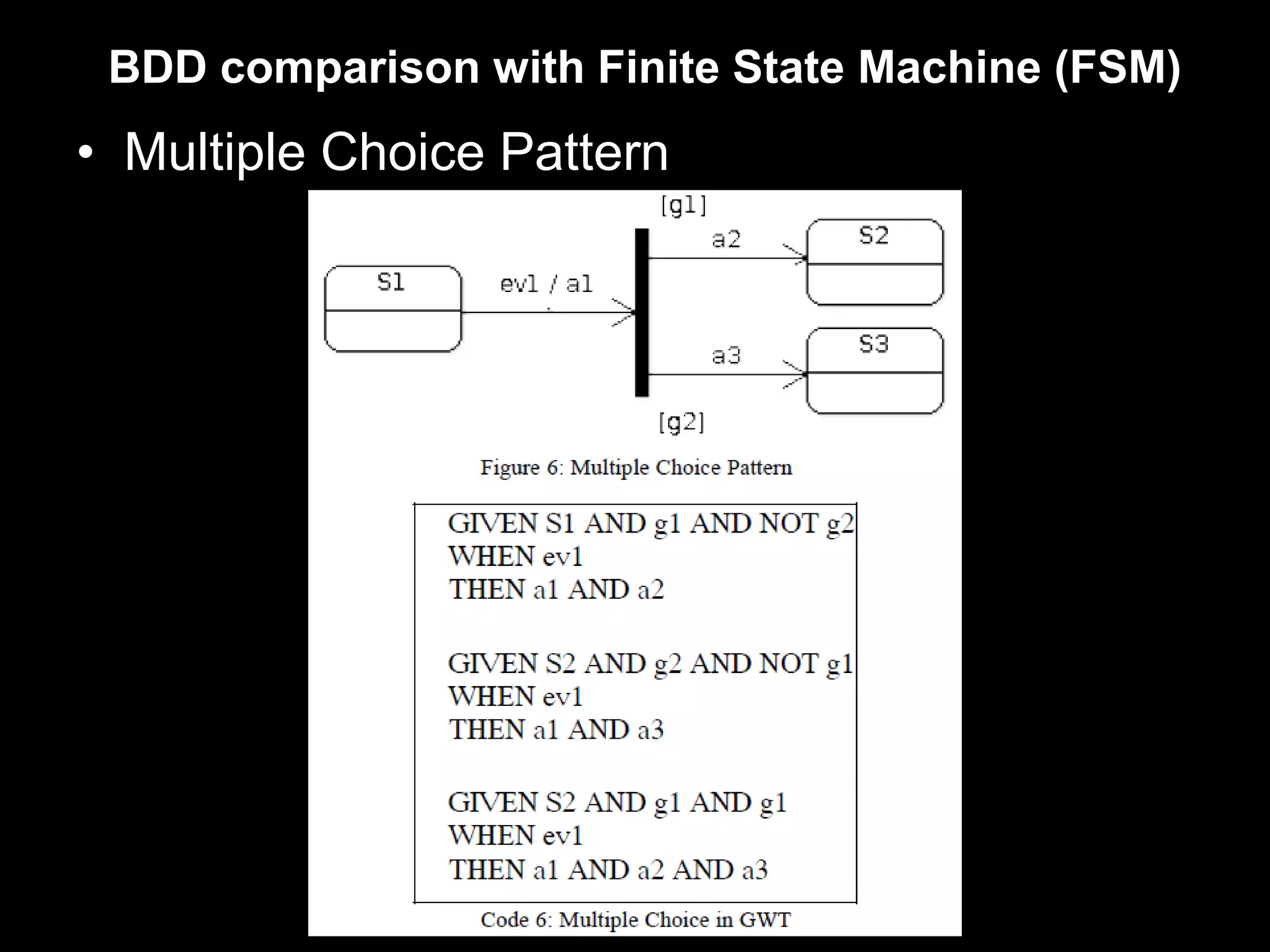

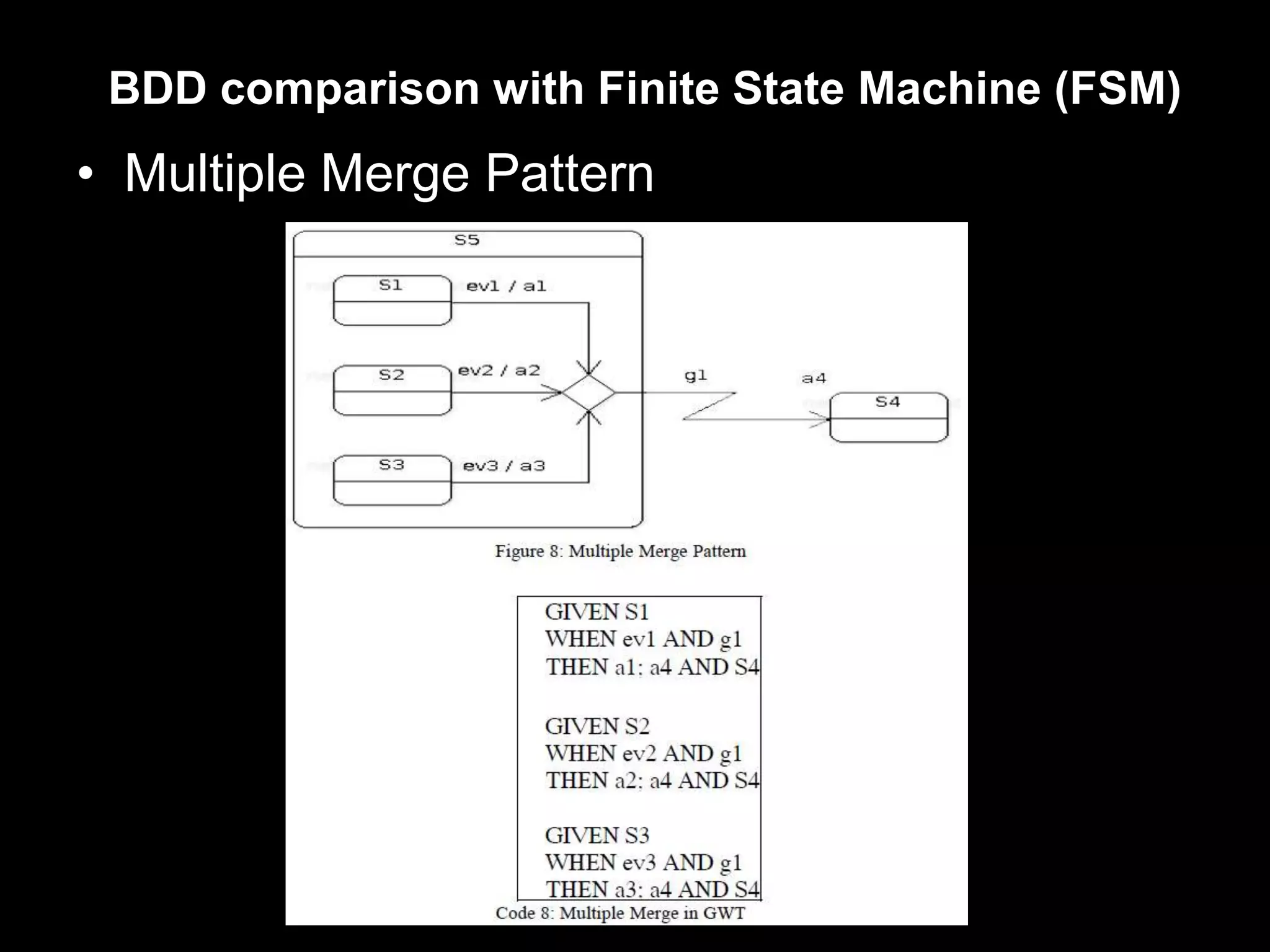

BDD comparison with Finite State Machine (FSM)

• Sequence Pattern      • Parallel Split Pattern
BDD comparison with Finite State Machine (FSM)

• Synchronization Pattern
BDD comparison with Finite State Machine (FSM)

• Exclusive Choice Pattern
BDD comparison with Finite State Machine (FSM)

• Simple Merge Pattern
BDD comparison with Finite State Machine (FSM)
• Multiple Choice Pattern
BDD comparison with Finite State Machine (FSM)

• Synchronization Merge Pattern
BDD comparison with Finite State Machine (FSM)
• Multiple Merge Pattern
Thank You

     Ajay Danait

     Global Agile Strategist
Stixis Technologies, Bangalore

Behavior Driven Development (BDD)

  • 1.
    Behavior Driven Development Ajay Danait Global Agile Strategist Stixis Technologies, Bangalore
  • 2.
    Co-Learning (Collaborative Learning) Cross Functional Behavior (10 mins)  Evolution of Software Development Process (15 mins)  Behavior Driven Development (BDD) Concept (10 mins)  Behavior Driven Development (BDD) Semantics (15 mins)  Q & A (10 mins)
  • 3.
    Quick Survey While doingsoftware development, who do you think like ... Like a … Plumber, Carpenter, Sculptor, Artist, Blacksmith, Hairdresser, Firefighter, Scientist, Archaeologist, Author, Typist
  • 4.
    Not Designations …But Roles Switch Caps Not Wear Crowns • Architect • Artist • Craftsman • Planner • Team Player • Critic • Engineer
  • 5.
    Team Organization andGovernance Traditional Team Hierarchy (Crowns) vs. Cross-Functional Roles (Caps) Project Leadership System Architecture Tech Architect Test Architect Test Business Creation Analysis Data Tech Lead Test Lead Architect Facilitator Leader Designer Test Analyst Guide Test Coach Project Automation Management Automation Tester Developer Build & Application Business Release Development Analyst Management Crowns Caps  Creates and widens gap between people  Swapped depending on situations  Restricts knowledge sharing  Increase sense of collective ownership  Builds up power distance  Rotation of responsibilities improves knowledge sharing  Steep learning curve for increase in maturity  Open culture within the team
  • 6.
    Quick Opinion Whendo you say a software project has "failed" ?
  • 7.
    Failure symptoms /Failure causes Software delivered very late ... costed way more ... does the wrong thing ... unstable in production, crashes a lot ... code change breaks functionality ... new version cannot be released very often
  • 8.
    Traditional Software DeliveryProcess Why Do We Do This ?
  • 9.
    Inheriting Management Stylefrom Traditional Industries  Fredrick Taylor  Edwards Deming / Taiichi Ohno  Taylorism (Scientific Management)  Deming Cycle / Lean Thinking (Work Management separation) (PDCA-Plan-Do-Check(Study)-Act)  Top Down  People need to be “managed”,  Bottom Up “controlled”, “monitored”.  People want to do a good job and take  Work needs to be made simple for pride in creativity. them or they will make mistakes. The  People respond well to an encouraging people downstream are increasingly environment of freedom and trust and dumb, pluggable / replaced. So, all the hence produce better results. “smartness” needed is loaded upfront in the form of “well-documented  People stress a lot on gaining artifacts” – requirements, designs, knowledge in the long term and improve user acceptance tests. their skills based on collaboration and apprenticeship.  Hence, there should be a proper knowledge transfer “handover” mechanism to make sure no data is lost in translation.  Also to “verify” based on documented evidence whether there are mistakes in the work that they do.
  • 10.
  • 11.
    Cost of Changefrom Traditional Industries  Lack of trust downstream  So we hedge  Detailed functional requirements  Big Design Up Front  Detailed UAT  Detailed Project Plan using Work Breakdown Structure until Task level  Discovering a defect / unexpected behavior  Causes increase in change and hence cost  To prevent this, we hedge with the phased process  We hedged so much to prevent high cost of change that we added steps that increase cost of change.
  • 12.
  • 13.
    Software Practices Inherited • V-Model Development Process • Upfront Detailed Planning • Fixed Scope Requirements (No changes) • Big Design Up Front • Hard Code (That cannot easily change) • Late Big Bang Integration • Limited Testing • Lots of handovers • Manual Deployments • Low Maintainability
  • 14.
    Software Delivery –Done Differently Vision Level Vision Statement V-Model to I-Model Goals (Changing a “waterfall” verification and validation testing mindset to spec-driven purpose fulfillment mindset) System / Product Level Executable Specifications Acceptance Feature Level Domain Driven Design Architecture Story Level Interface Driven Evolutionary Design Mocks Integration Scenario Level TDD / Unit Code-by-example Implementation
  • 15.
    Levels of Planning Who? Executive Mgmt. Vision Why? Product Management What? Product Product Owner Product Owner, When? Release Stakeholders, Team How? Iteration Product Owner, Team Daily Team
  • 16.
    What is different? • Deliver features instead of modules • Prioritize often, change often • Focus on high value features • Flatten the cost of change • Adapt to feedback • Fail fast, fail safe (Learn from failure) • Better Learning • Better collaboration than handover
  • 17.
    Evolution of SoftwarePractices • Adaptive Planning • Streamlined, Executable Specifications • Evolving Design (Just Enough Design) • Continuous Code Refactoring • Automated Acceptance Testing • Continuous Integration • Continuous Regression Testing • Continuous Automated Deployments • Highly Maintainable systems
  • 18.
    BDD – BehaviorDriven Development
  • 19.
    Concept • Behavior-Driven Development(BDD) is a term used to classify a method to build software by describing the application behavior from the perspective of and what is of value to the stakeholders. • Other terms associated with same concept – o Agile Acceptance Testing o Acceptance Test-Driven Development o Example-Driven Development o Code By Example o Story Testing o Story Test-Driven Development o Specification By Example
  • 20.
    Communication Effectiveness 2 people at white board 2 people on phone 2 people on email Videotape Audiotape Document Form of Communication
  • 21.
    Definition by DanNorth (Creator of BDD) “ Behavior-Driven Development (BDD) is a second-generation, outside-in, pull-based, multiple-stakeholder, multiple-scale, high- automation, agile methodology. It describes a cycle of interactions with well- defined outputs, resulting in the delivery of working, tested software. ”
  • 22.
    Second-Generation • Derived fromTDD, Acceptance Test Driven Planning, Lean and Domain Driven Design • Concepts of Neuro-Linguistic Programming (NLP) and Systems Thinking
  • 23.
    Outside-In, Multiple-Scope, Vision Level Vision Statement Multiple Stakeholders Purpose Who? System / Product Vision Level Why? Goals / Outcomes / Capabilities BDD Specifications What? Product Feature Level When? Release Domain Driven Design Architecture How? Iteration Story Level Interface Driven Evolutionary Design Mocks Daily Scenario Level TDD Code-by-example Implementation
  • 24.
    Pull-based • Just-enough details •Diminishing returns • Deliberate Discovery
  • 25.
  • 26.
    BDD Principles • JustEnough • Deliver stakeholder value • Behavior only
  • 27.
  • 28.
    User Story Template Asa [role] I want [feature] So that [benefit] Title [title of the story] In order to [benefit] A [role] Wants to [feature]
  • 29.
    User Story Example • Title: Register customers for VIP program In order to be able to do direct marketing of products to existing customers, a marketing manager wants customers to register personal details by joining a VIP program. • Title: Free delivery for VIP customers In order to entice existing customers to register for the VIP program, a marketing manager wants the system to offer free delivery on certain items to VIP customers.
  • 30.
    Scenario Template Title [titleof the scenario] Given [some initial context / system State] And [more context / system State] When [an event occurs / user Action occurs] Then [ensure outcome / system Reaction] And [some outcomes / system Reactions]
  • 31.
    Scenario Template • Title: Register customers for VIP program Given the customer registered for VIP program When the customer adds 5 books in the cart Then the customer gets free delivery • Title: Register customers for VIP program Given the customer registered for VIP program When the customer adds 4 books in the cart Then the customer does not get free delivery And the customer gets standard delivery • Title: Register customers for VIP program Given the customer registered for VIP program When the customer adds 5 washing machines in the cart Then the customer does not get free delivery And the customer gets standard delivery
  • 32.
    User Story &Scenario Example • Title: Customer withdraws cash In order to not want to wait in line at the bank, a customer wants to withdraw cash from the bank ATM • Title: Account is in credit Given the account is in credit And the card is valid And the dispenser contains cash When the customer request for cash withdrawal Then ensure the account is debited And ensure the cash is dispensed And ensure the card is returned
  • 33.
    User Story &Scenario Example • Title: Customer withdraws cash In order to not want to wait in line at the bank, a customer wants to withdraw cash from the bank ATM • Title: Account is overdrawn past the overdraft limit Given the account is overdrawn And the card is valid When the customer request for cash withdrawal Then ensure a rejection message is displayed And ensure the cash is not dispensed And ensure the card is returned
  • 34.
    BDD Characteristics • UbiquitousLanguage • Iterative Decomposition Process • Plain text description using Story and Scenarios templates • Automated Acceptance Testing with Mapping Rules • Readable Behavior Oriented Specification & code • Behavior Driven at different levels
  • 35.
    BDD Conceptual Model - A Study of the Characteristics of Behavior Driven Development - by Carlos Solís & Xiaofeng Wang
  • 36.
  • 37.
  • 38.
    BDD Mind Map - by Dan North
  • 39.
    BDD Tools • JBehave,NBehave • RSpec, MSpec • StoryQ, Cucumber, SpecFlow
  • 40.
    BDD Anti-Patterns • BDDis a framework with keywords & flavors • BDD is for defining system behavior and TDD for lower level components • BDD is for business applications and TDD is for API libraries • BDD is too explicit, verbose. • BDD is for higher level, TDD is for lower level • BDD is for integration testing, TDD is for unit testing • BDD is outside-in, TDD is inside-out.
  • 41.
    BDD comparison withFinite State Machine (FSM) • Sequence Pattern • Parallel Split Pattern
  • 42.
    BDD comparison withFinite State Machine (FSM) • Synchronization Pattern
  • 43.
    BDD comparison withFinite State Machine (FSM) • Exclusive Choice Pattern
  • 44.
    BDD comparison withFinite State Machine (FSM) • Simple Merge Pattern
  • 45.
    BDD comparison withFinite State Machine (FSM) • Multiple Choice Pattern
  • 46.
    BDD comparison withFinite State Machine (FSM) • Synchronization Merge Pattern
  • 47.
    BDD comparison withFinite State Machine (FSM) • Multiple Merge Pattern
  • 48.
    Thank You Ajay Danait Global Agile Strategist Stixis Technologies, Bangalore
