Agile Software Estimation - Sunil Kumar

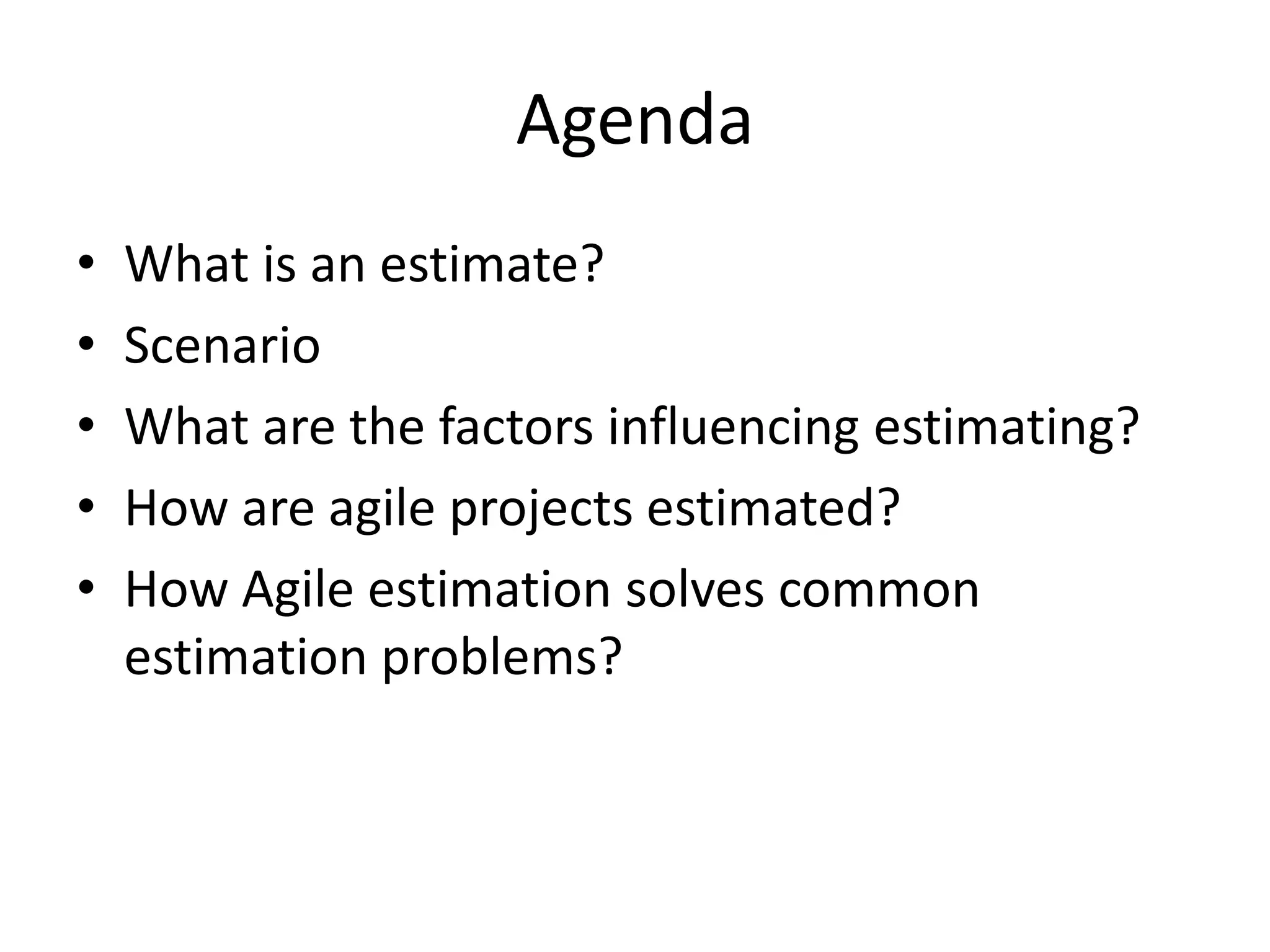

Agenda What is an estimate? Scenario What are the factors influencing estimating? How are agile projects estimated? How Agile estimation solves common estimation problems?
How to estimate this task ?
What is an estimate?     Unbiased, analytical process to predict the duration or cost of a project
Estimation is the calculated approximation of a result which is usable even if input data may be incomplete or uncertain.
What does the definition mean?
By definition estimate is not accurate
Estimation is prediction not PLAN
Typical first estimate is off by factor of 4
We are not good in absolute measurement
We are good in comparing things
Estimates are not commitments
Time is not persistent
Scenario You are told to estimate a project to “build a space shuttle that will land on moon” You say “It will take 6 months to 2 years” Your superior hears “It will take 6 months”. why? – optimism bias, organization, political and competitive pressures.
Scenario contd.. 6 month estimate breakup 1 month design 4 months implementation 1 month testing
Scenario 1 contd.. Design takes 5 weeks, late by 1 week How much did the project slip? 1 week? 25% ?
Answer 25% slip in project 25% of design = 1 week 25% of implementation = 1 month (approx 4 weeks) 25% of testing = 1 week Total slip in project = 6 weeks
Factors influencing estimating
Assumptions (domain jargon)
Anchoring (by customers)
Same specification ,[object Object]
Group A117 hours ,[object Object]
Group B173 hours
Irrelevant information for same spec ,[object Object],20 hours ,[object Object]
End user desktop apps
Usernames & passwords
Etc.
Group B39 hours
Extra requirements ,[object Object]
Group A4 hours ,[object Object]
Group B4 hours ,[object Object]
Group C8 hours
Given anchor ,[object Object],456 hours ,[object Object]
customer has no technical knowledge
Don’t let the customer influence you
Group B555 hours ,[object Object]
Group C99 hours
Biased opinion
Dominating opinion
Re estimation is considered heretic by most organizations so we overestimate by buffering
Overestimation downside: Goldratt’s student syndrome Eliyahu M. Goldratt
Competition, pressure from boss, peer-pressure, optimism bias, etc leads us to underestimate
Underestimating leads to project plan destruction
More bugs
Bad team health
More time in “status” meetings to discuss slippage
Time-based estimates are not additive for a team of varied skill set
What is the source of uncertainty in our projects?
Cloud of uncertainity (if the project is not well controlled)
Control the effects of overestimation and cloud of uncertainty using project planning and status visibility
Other factors influencing estimates Unstable requirements Forgetting to include the following while estimating Version control overhead Code review Build, installing More meetings Sick leaves etc
Always compare your estimates to your actuals or you’ll never be a better estimator Wisdom = Experience + reflection - Aristotle
Points to remember from Steve McConnell Narrow ranges != greater accuracy Don’t give off the cuff estimates Precision is not accuracy. The project will not take 233.725 hours Find something meaningful to count and keep a record of it. Use expert judgement only as a last resort
Estimation techniques Expert opinion Analogy Educated guess Disaggregating Planning poker – Agile estimation
Planning poker http://www.planningpoker.com/ Consensus-based estimation technique for estimating First described by James Grenningand later popularized by Mike Cohn in the book Agile Estimating and Planning
Planning Poker Estimated in story points for user stories*  It is most commonly used in agile software development First described by James Grenning in 2002 and later popularized by Mike Cohn in the book “Agile Estimating and Planning” For Eg: the deck contains the following cards: 0, ½, 1, 2, 3, 5, 8, 13, 20, 40, 100. User stories are user requirements of form "As a <Some Role> I want <Some Need> so that <Some Benefit>”
Planning Poker Each person gets a deck of cards. The story to be estimated is read to all. Attendants ask clarifications for the item. Each person selects a card and puts it on the table facing down. When everyone is done, cards are exposed. If the estimations do not match a short discussion is done.  Timer is started for discussion and discussion must cease when it runs out -> Goto 4. Handle next item.
