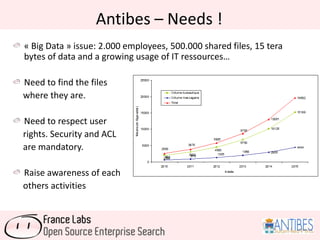

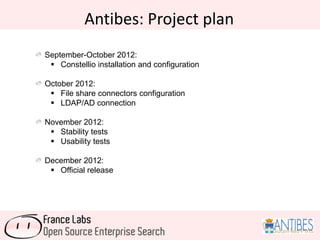

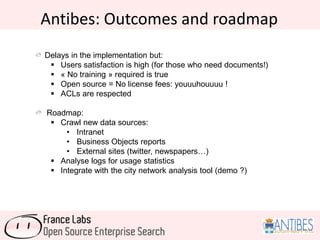

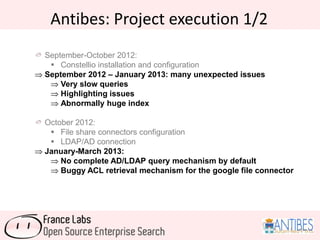

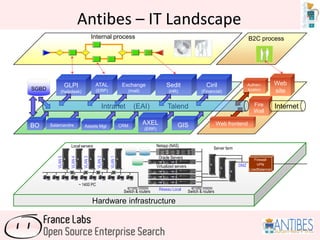

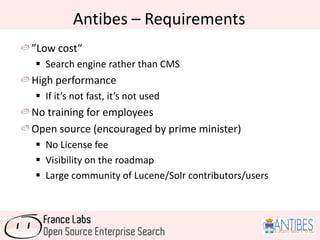

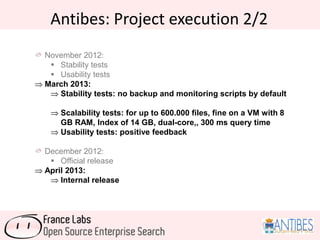

The document outlines a project by France Labs to implement an open-source search engine, Constellio, for the City of Antibes to address their 'big data' challenges and improve file accessibility. The project plan, spanning from installation to testing, faced delays but resulted in high user satisfaction due to its low-cost, open-source nature without the need for employee training. Future developments include expanding the system to crawl new data sources and integrating with existing city tools.
