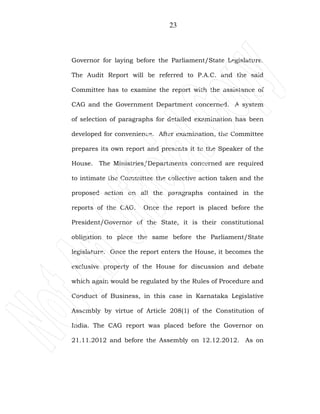

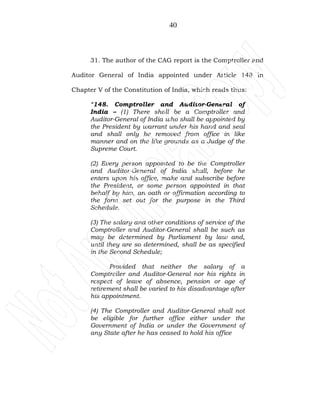

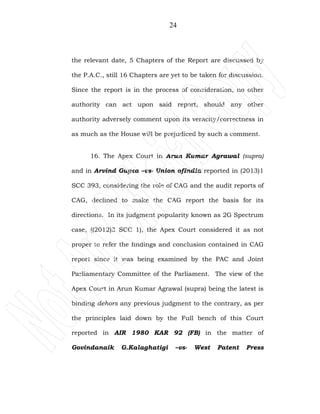

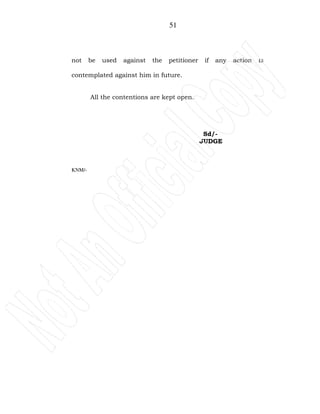

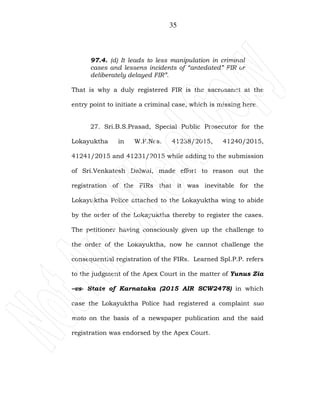

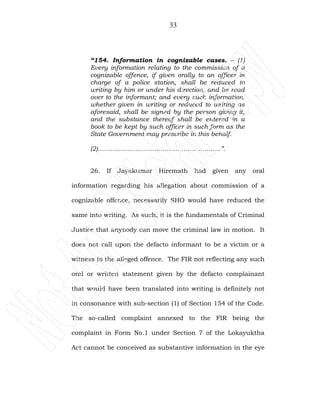

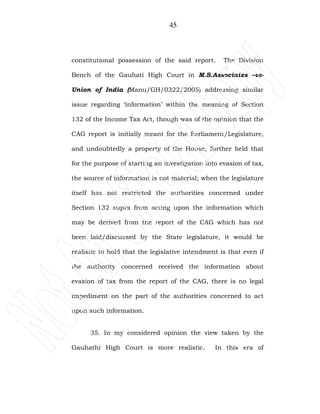

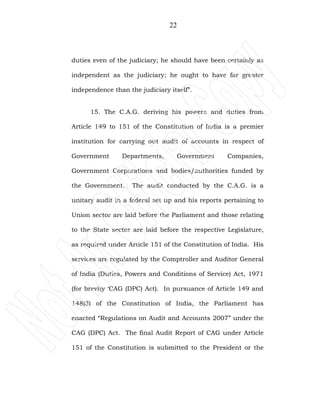

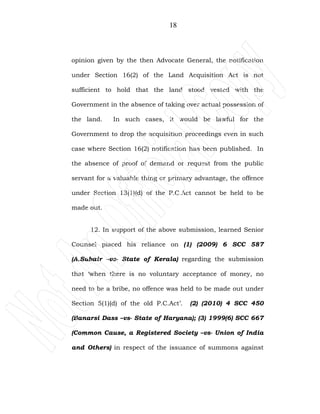

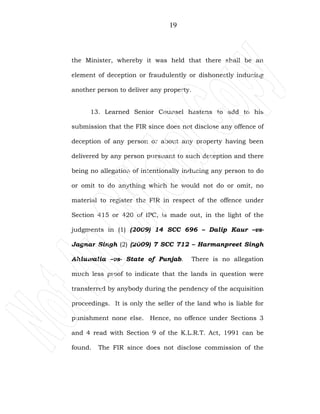

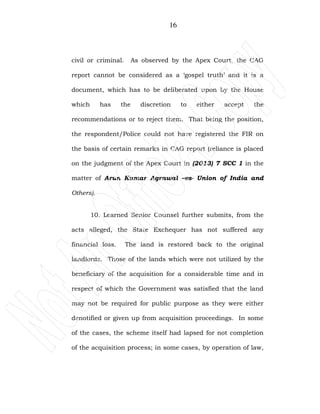

The document is a high court order involving multiple writ petitions filed by former Chief Minister B.S. Yeddyurappa, challenging the FIRs registered against him based on a Comptroller and Auditor General report concerning alleged irregularities in land denotification. The court proceedings stem from a complaint by activist Jayakumar Hiremath, and the petitioner argues that the FIRs should be quashed due to a lack of specific legal allegations and that the report cannot be used as a basis for criminal charges. The common question raised is regarding the legality of using the CAG report against the petitioner and the validity of the FIRs registered based on it.
