This document is Amendment No. 6 to Contract No. C-48689 between the City and County of Honolulu and Waste Management of Hawaii, Inc. It amends the contract in the following ways:

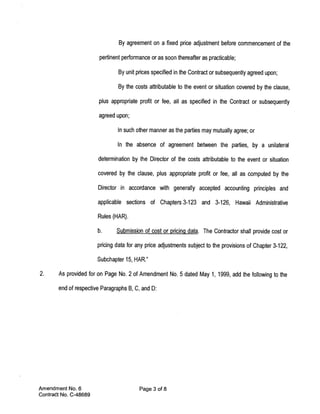

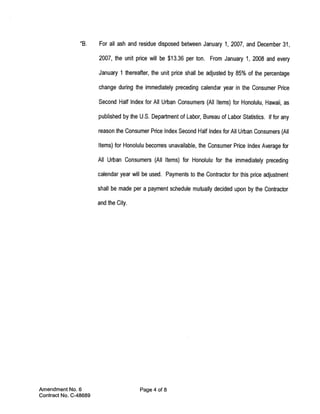

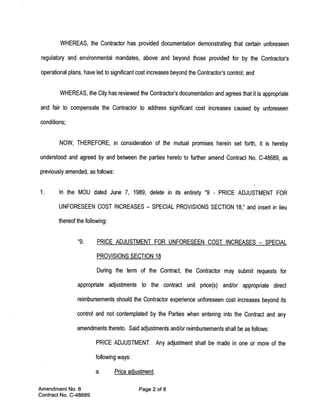

1. It restores a provision allowing for price adjustments for unforeseen cost increases beyond the contractor's control.

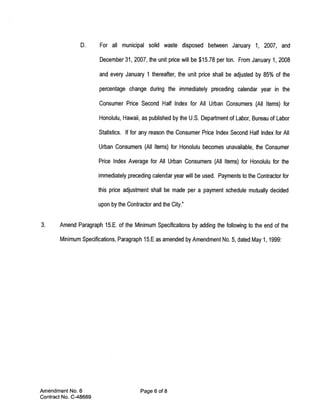

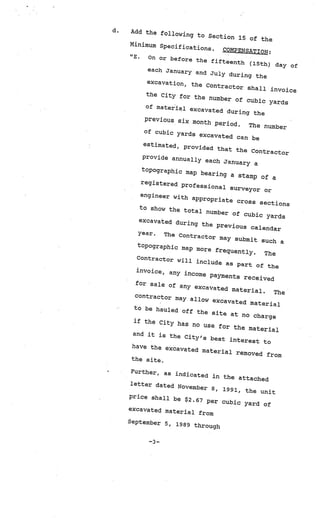

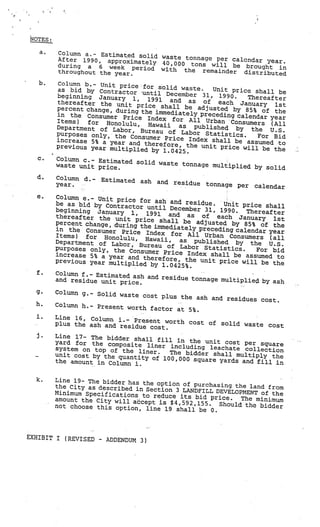

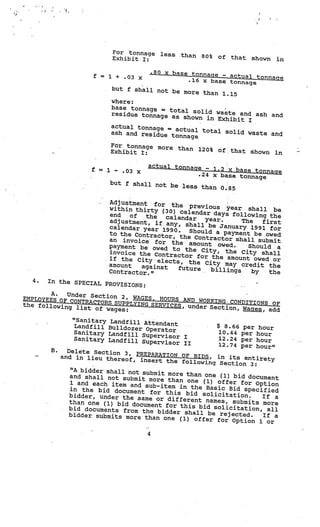

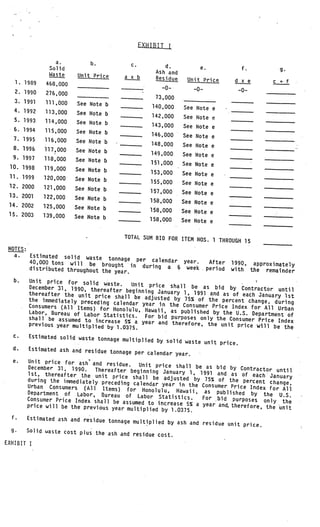

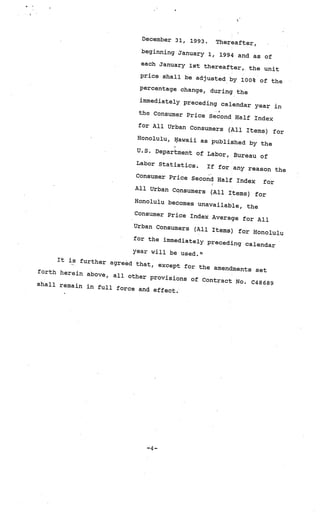

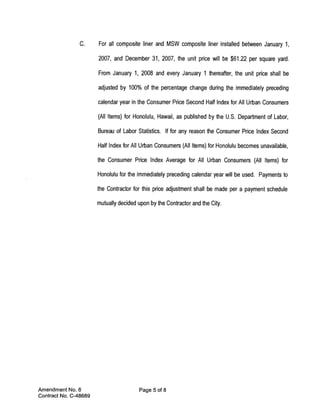

2. It updates the unit prices for ash/residue disposal, composite liner installation, and municipal solid waste disposal starting in 2007 and provides an annual adjustment based on the Consumer Price Index.

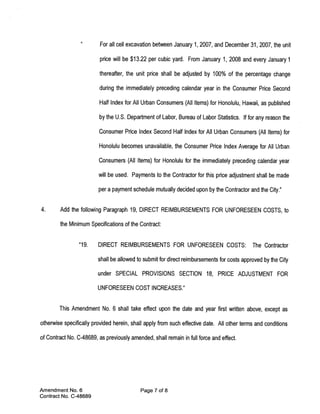

3. It updates the unit price for cell excavation starting in 2007 and provides an annual adjustment based on the Consumer Price Index.
