TRIPSAVER A Logistical Analysis BY VENKITASUBRAMANIAN AKSHAY Graduate Student in Industrial and Systems Engineering, North Carolina State University  Student Assistant, Research and Information Services- NCSU Libraries, North Carolina State University

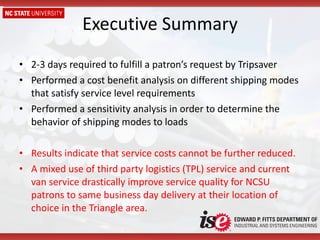

Executive Summary 2-3 days required to fulfill a patron’s request by Tripsaver Performed a cost benefit analysis on different shipping modes that satisfy service level requirements  Performed a sensitivity analysis in order to determine the behavior of shipping modes to loads Results indicate that service costs cannot be further reduced. A mixed use of third party logistics (TPL) service and current van service drastically improve service quality for NCSU patrons to same business day delivery at their location of choice in the Triangle area.

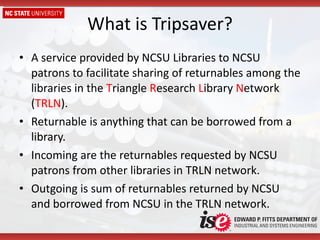

What is Tripsaver? A service provided by NCSU Libraries to NCSU patrons to facilitate sharing of returnables among the libraries in the  T riangle  R esearch  L ibrary  N etwork ( TRLN ).  Returnable is anything that can be borrowed from a library. Incoming are the returnables requested by NCSU patrons from other libraries in TRLN network. Outgoing is sum of returnables returned by NCSU and borrowed from NCSU in the TRLN network.

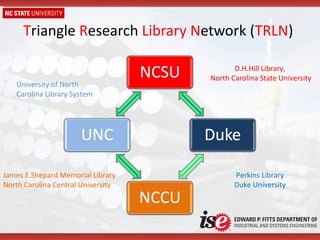

T riangle  R esearch  Library   N etwork ( TRLN )  University of North Carolina Library System D.H.Hill Library, North Carolina State University Perkins Library Duke University James.E.Shepard Memorial Library North Carolina Central University

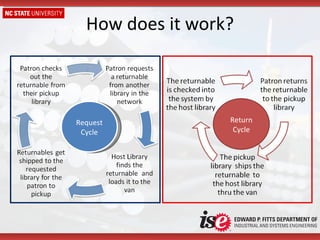

How does it work? Request Cycle Return Cycle

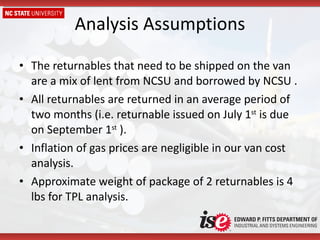

The returnables that need to be shipped on the van are a mix of lent from NCSU and borrowed by NCSU .  All returnables are returned in an average period of two months (i.e. returnable issued on July 1 st  is due on September 1 st  ). Inflation of gas prices are negligible in our van cost analysis. Approximate weight of package of 2 returnables is 4 lbs for TPL analysis. Analysis Assumptions

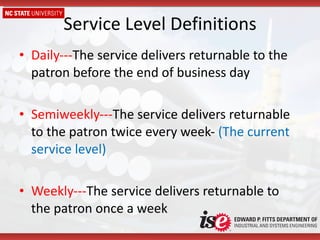

Service Level Definitions Daily--- The service delivers returnable to the patron before the end of business day Semiweekly--- The service delivers returnable to the patron twice every week-  (The current service level) Weekly--- The service delivers returnable to the patron once a week

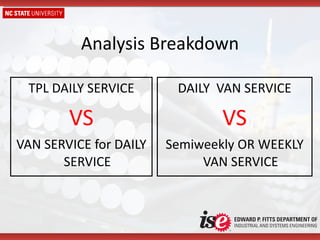

Analysis Breakdown TPL DAILY SERVICE VS VAN SERVICE for DAILY SERVICE DAILY  VAN SERVICE VS Semiweekly OR WEEKLY VAN SERVICE
Third Party Logistics Analysis UPS was chosen as the TPL for TRLN study as they already work with the interlibrary service (i.e. outside the TRLN) The UPS rate used for the analysis is the service rate for 2-3 business days for interlibrary loans Hence, this UPS rate can be applied for same day delivery in the Triangle  area.

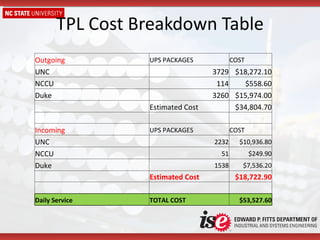

TPL Cost Breakdown Table Outgoing UPS PACKAGES COST UNC 3729 $18,272.10 NCCU 114 $558.60 Duke 3260 $15,974.00   Estimated Cost $34,804.70       Incoming UPS PACKAGES COST UNC 2232 $10,936.80 NCCU 51 $249.90 Duke 1538 $7,536.20   Estimated Cost $18,722.90       Daily Service TOTAL COST $53,527.60

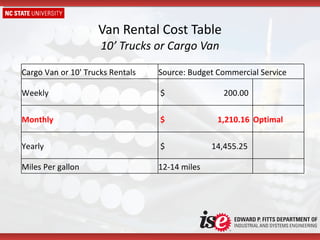

Van Rental Cost Table 10’ Trucks or Cargo Van Cargo Van or 10' Trucks Rentals  Source: Budget Commercial Service Weekly $  200.00    Monthly $  1,210.16  Optimal Yearly $  14,455.25    Miles Per gallon 12-14 miles

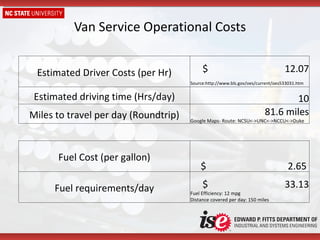

Van Service Operational Costs Estimated Driver Costs (per Hr) $  12.07 Source:http://www.bls.gov/oes/current/oes533031.htm   Estimated driving time (Hrs/day) 10 Miles to travel per day (Roundtrip) 81.6 miles Google Maps- Route: NCSU<->UNC<->NCCU<->Duke Fuel Cost (per gallon) $  2.65  Fuel requirements/day $  33.13 Fuel Efficiency: 12 mpg  Distance covered per day: 150 miles
Van Service Cost Breakdown Service Level Days of Service Fuel Req Driver Cost Van rental Total Cost Daily 260 $  8,612.50  $  31,382.00  $  14,521.92  $  54,516.42  Bi weekly  122 $  4,041.25  $  14,725.40  $  14,521.92  $  33,288.57  Weekly 52 $  1,722.50  $  6,276.40  $  14,521.92  $  22,520.82

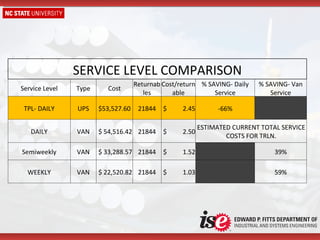

SERVICE LEVEL COMPARISON Service Level Type Cost Returnables Cost/returnable % SAVING- Daily Service % SAVING- Van Service TPL- DAILY UPS $53,527.60 21844 $  2.45  -66%   DAILY VAN $ 54,516.42  21844 $  2.50  ESTIMATED CURRENT TOTAL SERVICE COSTS FOR TRLN. Semiweekly VAN $ 33,288.57  21844 $  1.52    39% WEEKLY VAN $ 22,520.82  21844 $  1.03    59%

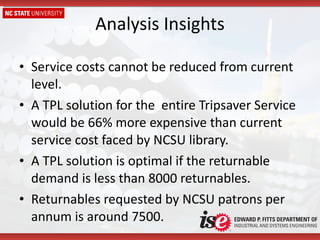

Analysis Insights Service costs cannot be reduced from current level. A TPL solution for the  entire Tripsaver Service would be 66% more expensive than current service cost faced by NCSU library. A TPL solution is optimal if the returnable demand is less than 8000 returnables. Returnables requested by NCSU patrons per annum is around 7500.

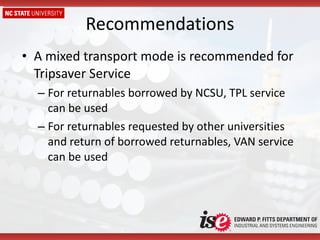

Recommendations A mixed transport mode is recommended for Tripsaver Service For returnables borrowed by NCSU, TPL service can be used For returnables requested by other universities and return of borrowed returnables, VAN service can be used

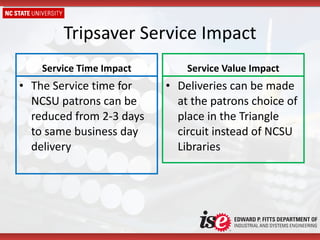

Tripsaver Service Impact Service Time Impact The Service time for NCSU patrons can be reduced from 2-3 days to same business day delivery Service Value Impact Deliveries can be made at the patrons choice of place in the Triangle  circuit instead of NCSU Libraries

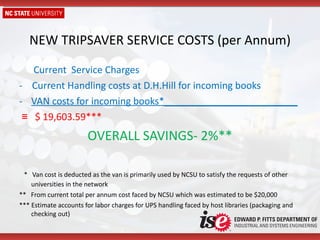

NEW TRIPSAVER SERVICE COSTS (per Annum) Current  Service Charges -  Current Handling costs at D.H.Hill for incoming books VAN costs for incoming books*_________________________ ≡  $ 19,603.59*** OVERALL SAVINGS- 2%** *  Van cost is deducted as the van is primarily used by NCSU to satisfy the requests of other universities in the network **  From current total per annum cost faced by NCSU which was estimated to be $20,000 *** Estimate accounts for labor charges for UPS handling faced by host libraries (packaging and checking out)

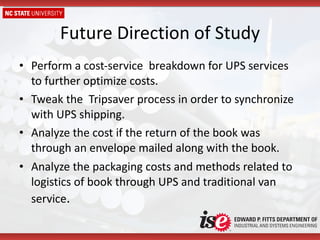

Future Direction of Study Perform a cost-service  breakdown for UPS services  to further optimize costs. Tweak the  Tripsaver process in order to synchronize with UPS shipping. Analyze the cost if the return of the book was through an envelope mailed along with the book. Analyze the packaging costs and methods related to logistics of book through UPS and traditional van service .
ANY QUESTIONS?

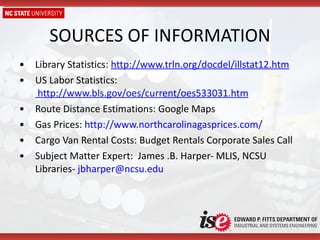

SOURCES OF INFORMATION Library Statistics:  http://www.trln.org/docdel/illstat12.htm US Labor Statistics:   http://www.bls.gov/oes/current/oes533031.htm Route Distance Estimations: Google Maps Gas Prices:  http://www.northcarolinagasprices.com/   Cargo Van Rental Costs: Budget Rentals Corporate Sales Call  Subject Matter Expert:  James .B. Harper- MLIS, NCSU Libraries-  [email_address]
THANK YOU!
