e-PM
Synefra Infrastructures Ltd.
ExcellenceinProjectManagement
Synefra stands for Synergy in Infrastructure - an integrated synergized approach that defines and symbolizes
every program of Synefra. The ‘E’ that binds Synergy & Infrastructure symbolizes our core business focus on
Efficiency,Effectiveness,Excellence,EconomicsandEnvironment.
Synefra Infrastructures Ltd. (A Tanti Group Company) formerly known as Suzlon Infrastructure Ltd., was
establishedin1998 toconceptualize,invest,develop&maintainhi-techindustrialinfrastructureglobally.
With a team of experienced professionals comprising of Engineers, Architects, Finance and Project
Managementspecialists,Synefraoffersawidearrayofspecializedservicesin:
• Architectural Design • Program Management
• Building Engineering Design • Engineering Solutions
• Sustainability Solutions • Construction Management
e-PM (Excellence in Project Management)
e-PM vertical of Synefra provides ‘concept to completion’ Project Management services to the infrastructure
sector. Synefra’s experience in large scale projects in China, Europe, India and the USA make it an ideal project
manager. The Project Management teams are trained and experienced in development and implementation
of the best processes and systems customized to the client’s need, delivering the desired results and
achievingtheprojectgoalsofTime,CostandScope.
With more than a decade of cross-functional expertise, Synefra today has evolved as an Innovative
Infrastructure Solutions provider to various business segments. Having successfully delivered over
150 projects globally, with a footprint of 1400 acres of SEZ development, building over 3 million sq. ft.
of industrial spaces and more than 1.5 million sq. ft. of top class office spaces, campuses, R&D
centres, Training & Learning academies and social infrastructure, Synefra is geared to deliver world
classinfrastructuresolutionswithin-houseexpertise.

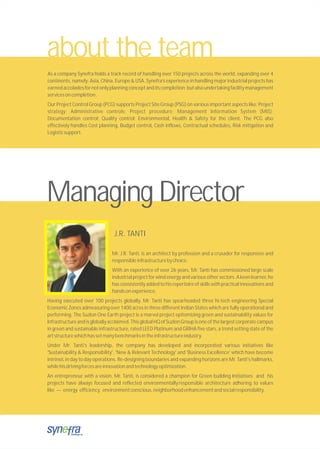

about the team
As a company Synefra holds a track record of handling over 150 projects across the world, expanding over 4
continents, namely: Asia, China, Europe & USA. Synefra’s experience in handling major industrial projects has
earnedaccoladesfornotonlyplanningconceptanditscompletion;butalsoundertakingfacilitymanagement
servicesoncompletion.
Our Project Control Group (PCG) supports Project Site Group (PSG) on various important aspects like: Project
strategy; Administrative controls; Project procedure; Management Information System (MIS);
Documentation control; Quality control; Environmental, Health & Safety for the client. The PCG also
effectively handles Cost planning, Budget control, Cash inflows, Contractual schedules, Risk mitigation and
Logisticsupport.
Managing Director
Mr. J.R. Tanti, is an architect by profession and a crusader for responsive and
responsibleinfrastructurebychoice.
With an experience of over 26 years, Mr. Tanti has commissioned large scale
industrialprojectforwindenergyandvariousothersectors.Akeenlearner,he
has consistently added to his repertoire of skills with practical innovations and
handsonexperience.
Having executed over 100 projects globally, Mr. Tanti has spearheaded three hi-tech engineering Special
Economic Zones admeasuring over 1400 acres in three different Indian States which are fully operational and
performing. The Suzlon One Earth project is a marvel project epitomizing green and sustainability values for
Infrastructureandisgloballyacclaimed.ThisglobalHQofSuzlonGroupisoneofthelargestcorporatecampus
in green and sustainable infrastructure, rated LEED Platinum and GRIHA five stars, a trend setting state of the
artstructurewhichhassetmanybenchmarksintheinfrastructureindustry.
Under Mr. Tanti's leadership, the company has developed and incorporated various initiatives like
'Sustainability & Responsibility', 'New & Relevant Technology' and 'Business Excellence' which have become
intrinsic in day to day operations. Re-designing boundaries and expanding horizons are Mr. Tanti's hallmarks,
whilehisdrivingforcesareinnovationandtechnologyoptimization.
An entrepreneur with a vision, Mr. Tanti, is considered a champion for Green building Initiatives and his
projects have always focused and reflected environmentallyresponsible architecture adhering to values
like --- energy efficiency, environmentconscious,neighborhoodenhancementandsocialresponsibility.
J.R. TANTI
PHILOSOPHY
What differentiates Synefra from regular brick and mortar services provided by infrastructure solution
providers? It is our philosophy! A philosophy that stems from our core values of knowledge and quality;
creatingconstantchallengestobetterourselvesandproviding‘earth-friendly’solutions.
Wearenot justabout theexecution,but the‘thinking’behindit.AtSynefra,ourthinking,rightfrominception
is inclined towards overcoming challenges. In the field of infrastructure, as in life, the word ‘impossible’ is
actuallyan‘opportunity’toexplorepotentialsandtestcapabilities.
With our core competencies like Conceptualization, Design Development, Engineering Innovations, Project
ManagementTechnologyApplication, wehavechallengedeachquestionthatwehavefacedwithandreplied
successfullywhilecreatingbenchmarkprojectsforourclients.
Challenge us, our business verticals are our pillars of strength, have never let us down. We are Synefra, and
challengesarewhatkeepusgoing.
VISION
We will be an Industry Leader in Design Engineering, Construction and Services providing Total Quality and
Cost-Effective Integrated Solutions on time, setting industry benchmarks, achieving customer satisfaction
anddedicatedtosustainabledevelopment.
We will continually work towards employee development by providing a conducive work environment that
empowersthroughknowledgeandinnovation.
Synefra Infrastructures Ltd. is poised to provide quality services at optimum costs by way of continuous
processimprovementforbothcustomersaswellasitsemployees.
Ourresponsibilityistoensurethatthoroughestablishedstandardsandproceduresarebeingfollowedsothat
thelevelofqualitymatches,orevenexceeds,thecustomer'sexpectations.
We develop quality awareness through continuous process improvement and imparting training to our
employeesperiodically.Qualityisanintegralpartofourcommitmenttoworldclassservices.
OurqualityprocessIncludes:
• Verifyingandvalidatingbothexistingaswellasnewprogramfunctions
• Researchimprovementstoaddtothequalityofourservices
• Helpingtodefineandimproveourservicesthroughinvolvementwithouremployeesandourcustomers
• Conducting internal quality audits and management review for our ongoing evaluation and improvement
ofourqualitysystem
• Verifyandvalidatetheprocessesandproceduresofvariousservicesbeforeitreachesthecustomer
Y PT OIL LA ICU YQ
The'e'ine-PMrepresentsthestrongdesirewithinourcompanytostriveforexcellence.
Excellence-Efficacy-Engineering-Engagement-Effectiveness-Efficiency-Edge-Energy
e-PMoperatesdeployinginternationallyacceptedstandardsincluding:
• ISO 9001:2008 for Quality
• ISO 14001:2004 for Environment
• OHSAS 18001:2007 for Safety
Our teams carry wealth of knowledge and experience in operating under various geographical, cultural, political and financial
environments. Past projects have been located in USA, China, Europe and Asia, wherein sub-zero temperatures, time zones, language
barriers,logisticsandcoordinationissueshaveallbeensuccessfullynegotiated.
our esteemed clients
We also offer task-oriented services customized to client needs like:
• Technical due diligence/feasibility study • Third Party Audits
• Cost Management & Quantity Survey • Quality Management Process Set up
Project Management
Project Monitoring
Construction Management
Design Management
Green Building Consultancy
& Certification
CLOSE OUTMONITORING
& CONTROLEXECUTIONPLANNINGINITIATION
We have developed a team of professionally qualified people who bring in rich and diverse skill sets and
experience from the industry.
Thus a unique e-PM service delivery model has been designed, keeping our clients and their requirements
in the centre. The project management teams at Synefra are backed by a real-time knowledge hub, which
acts as a project control group.
Activities
• Establish design sign off process and delivery
• Identify information gaps
• Value Management
• Identify environmental and sustainability targets
• Monitor design progress deliverables
• Design coordination
• Develop Contractor selection and appointment process
• Implement Design Change Control
Deliverables
• Design Basis Reports (By Design Team)
• Procurement Strategy
• Preliminary cost plans at each stage
(pre-tender estimate)
• Revised Design Brief (Sign Off)
• Design Sign of
• Sign Off Budgets
Activities
• Develop Strategy
• Compile Bid Document
• Vendor Pre-qualification
• Issue Bid Package
• Identify long lead items
• Conduct Bidding Process
• Technical and
commercial negotiations
Deliverables
• Tender documentation
• Bid Evaluation &
Recommendation
• Reports
• Contracts/PO
ASSESS DEVELOP
scope of
Pre - ConstructionDesign & Development
Activities
• Site logistics, planning and
mobilisation
• Construction Supervision
• Contract Administration
• Change Management
• Monitoring of construction against
cost and program and expectations
• Testing and Commissioning
• Prepare H&S File and O&M’s
• Migration Planning
• Completion of works and Handover
Deliverables
• Construction Program Reports
• Cost Reports
• Invoice Certifications
• Change Orders
• Deviations
DELIVER
Construction
services
geographies
Synefra Infrastructures Ltd. works primarily in
Gujarat, Maharashtra, Karnataka & Tamil Nadu.
Our network of offices and partners allows for
quick and easy mobilization turn-around time,
which benefits our clients in early mobilization and
project initiation.
LEGEND
Head Office
Registered Office
Offices
Project Offices
Ahmadabad
Pune
KARNATAKA
TAMIL
NADU
MAHARASHTRA
GUJARAT
Bangalore
Chennai
MADHYA PRADESH
RAJASTHAN
GOA
ANDHRA
PRADESH
DELHI
Chakan
Padubidri
Karumathampatti
Waghodia
Mumbai
Coimbatore
Jaipur
Jodhpur
IndoreRajkot
Hyderabad
Panjim
New
Delhi

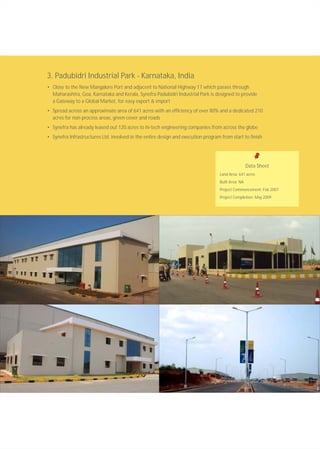

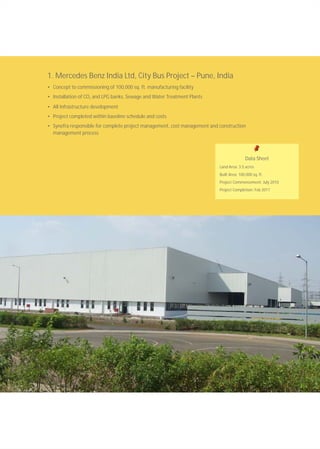

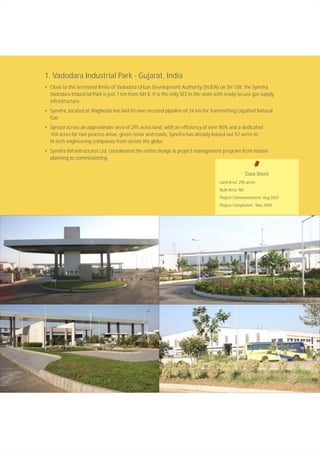

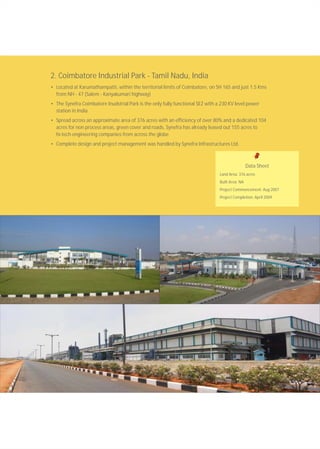

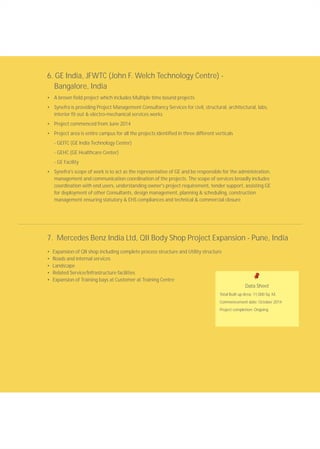

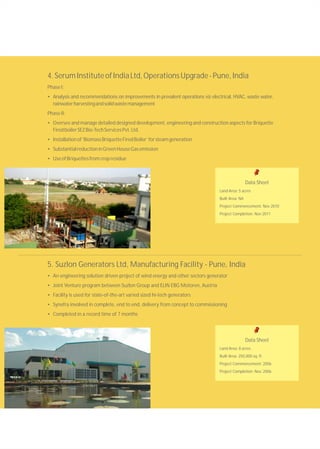

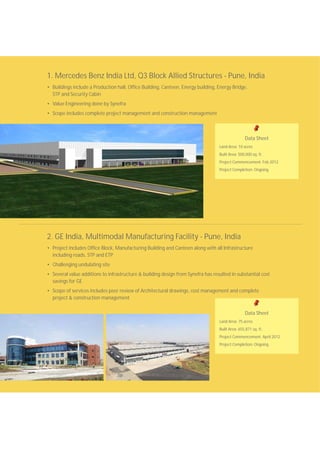

Completed Projects
A. CorporateOffices
B. Industrial&ManufacturingProjects
C. IndustrialParks

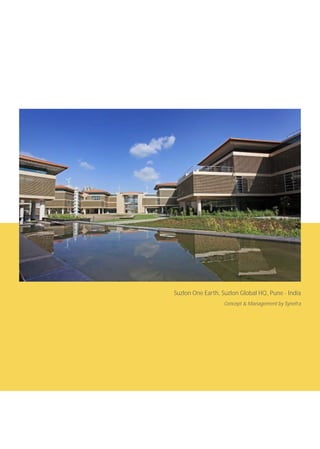

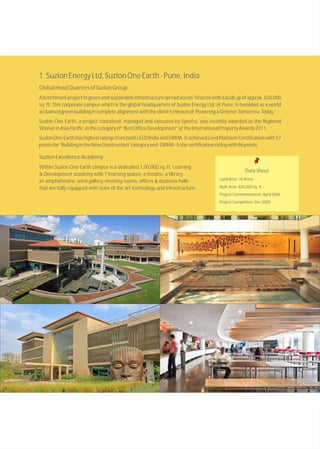

1.SuzlonEnergyLtd,SuzlonOneEarth-Pune,India
GlobalHeadQuartersofSuzlonGroup
Abenchmarkproject in greenand sustainableinfrastructurespread across 10acreswitha builtup of approx.820,000
sq. ft. This corporate campus which is the global headquarters of Suzlon Energy Ltd. at Pune, is heralded as a world
acclaimedgreenbuildingincompletealignmentwiththeclient’smissionof‘PoweringaGreenerTomorrow,Today.’
Suzlon One Earth, a project conceived, managed and executed by Synefra. was recently awarded as the Regional
WinnerinAsiaPacific,inthecategoryof“BestOfficeDevelopment”attheInternationalPropertyAwards2011.
Suzlon One Earth has highest ratings from both LEED India and GRIHA. It achieved Leed Platinum Certification with 57
pointsfor‘BuildingintheNewConstruction'categoryand GRIHA-5starcertificationratingwith96points.
SuzlonExcellenceAcademy
Within Suzlon One Earth campus is a dedicated 1,00,000 sq. ft. Learning
& Development academy with 7 learning spaces, a theatre, a library,
an amphitheatre, wind gallery, meeting rooms, offices & business halls
that are fully equipped with state of the art technology and infrastructure.
Data Sheet
Land Area: 10 Acres
Built Area: 820,000 sq. ft.
Project Commencement: April 2006
Project Completion: Dec 2009

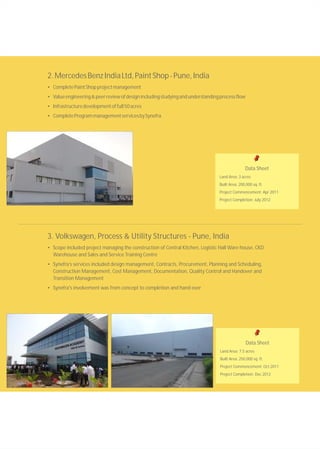

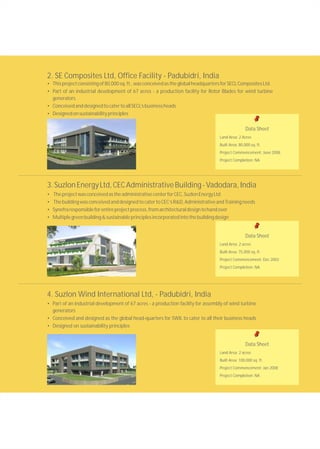

2. SE Composites Ltd, Office Facility - Padubidri, India
• Thisprojectconsistingof80,000sq.ft.,wasconceivedastheglobalheadquartersforSECLCompositesLtd.
• Part of an industrial development of 67 acres - a production facility for Rotor Blades for wind turbine
generators
• ConceivedanddesignedtocatertoallSECL’sbusinessheads
• Designedonsustainabilityprinciples
Data Sheet
Land Area: 2 Acres
Built Area: 80,000 sq. ft.
Project Commencement: June 2008
Project Completion: NA

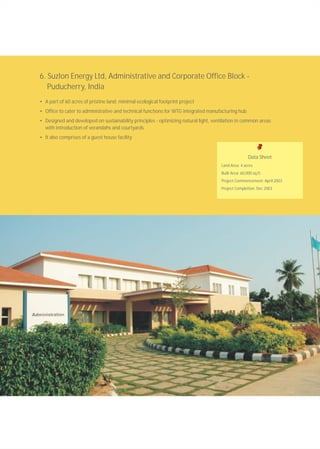

3.SuzlonEnergyLtd,CECAdministrativeBuilding-Vadodara,India
• TheprojectwasconceivedastheadministrativecenterforCEC,SuzlonEnergyLtd.
• ThebuildingwasconceivedanddesignedtocatertoCEC’sR&D,AdministrativeandTrainingneeds
• Synefraresponsibleforentireprojectprocess,fromarchitecturaldesigntohandover
• Multiplegreenbuilding&sustainableprinciplesincorporatedintothebuildingdesign
Data Sheet
Land Area: 2 acres
Built Area: 75,000 sq. ft.
Project Commencement: Dec 2003
Project Completion: NA
4. Suzlon Wind International Ltd, - Padubidri, India
• Part of an industrial development of 67 acres - a production facility for assembly of wind turbine
generators
• Conceived and designed as the global head-quarters for SWIL to cater to all their business heads
• Designed on sustainability principles
Data Sheet
Land Area: 2 acres
Built Area: 100,000 sq. ft.
Project Commencement: Jan 2008
Project Completion: NA

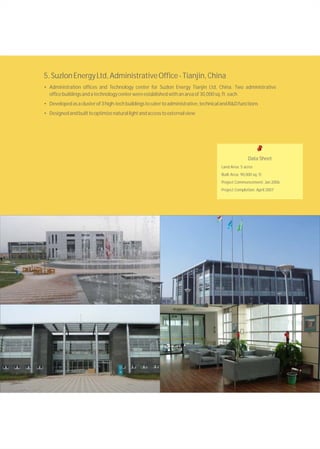

5.SuzlonEnergyLtd,AdministrativeOffice-Tianjin,China
• Administration offices and Technology center for Suzlon Energy Tianjin Ltd, China. Two administrative
officebuildingsandatechnologycenterwereestablishedwithanareaof30,000sq.ft.each
• Developedasaclusterof3high-techbuildingstocatertoadministrative,technicalandR&Dfunctions
• Designedandbuilttooptimizenaturallightandaccesstoexternalview
Data Sheet
Land Area: 5 acres
Built Area: 90,000 sq. ft.
Project Commencement: Jan 2006
Project Completion: April 2007
6. Suzlon Energy Ltd, Administrative and Corporate Office Block -
Puducherry, India
• A part of 60 acres of pristine land; minimal ecological footprint project
• Office to cater to administrative and technical functions for WTG integrated manufacturing hub
• Designed and developed on sustainability principles - optimizing natural light, ventilation in common areas
with introduction of verandahs and courtyards
• It also comprises of a guest house facility
Data Sheet
Land Area: 4 acres
Built Area: 60,000 sq.ft.
Project Commencement: April 2003
Project Completion: Dec 2003
Completed Projects
Industrial & Manufacturing
Projects
1. Mercedes Benz India Ltd, City Bus Project – Pune, India
• Concept to commissioning of 100,000 sq. ft. manufacturing facility
• Installation of CO and LPG banks, Sewage and Water Treatment Plants2
• All Infrastructure development
• Project completed within baseline schedule and costs
• Synefra responsible for complete project management, cost management and construction
management process
Data Sheet
Land Area: 3.5 acres
Built Area: 100,000 sq. ft.
Project Commencement: July 2010
Project Completion: Feb 2011
2.MercedesBenzIndiaLtd,PaintShop-Pune,India
• CompletePaintShopprojectmanagement
• Valueengineering&peerreviewofdesignincludingstudyingandunderstandingprocessflow
• Infrastructuredevelopmentoffull50acres
• CompleteProgrammanagementservicesbySynefra
Data Sheet
Land Area: 3 acres
Built Area: 200,000 sq. ft.
Project Commencement: Apr 2011
Project Completion: July 2012
3. Volkswagen, Process & Utility Structures - Pune, India
• Scope included project managing the construction of Central Kitchen, Logistic Hall Ware house, CKD
Warehouse and Sales and Service Training Centre
• Synefra’s services included design management, Contracts, Procurement, Planning and Scheduling,
Construction Management, Cost Management, Documentation, Quality Control and Handover and
Transition Management
• Synefra's involvement was from concept to completion and hand over
Data Sheet
Land Area: 7.5 acres
Built Area: 250,000 sq. ft.
Project Commencement: Oct 2011
Project Completion: Dec 2012
4.SerumInstituteofIndiaLtd,OperationsUpgrade-Pune,India
PhaseI:
• Analysis and recommendations on improvements in prevalent operations viz electrical, HVAC, waste water,
rainwaterharvestingandsolidwastemanagement
PhaseII:
• Oversee and manage detailed designed development, engineering and construction aspects for Briquette
FiredboilerSEZBio-TechServicesPvt.Ltd.
• Installationof‘BiomassBriquetteFiredBoiler’forsteamgeneration
• SubstantialreductioninGreenHouseGasemission
• UseofBriquettesfromcropresidue
Data Sheet
Land Area: 5 acres
Built Area: NA
Project Commencement: Nov 2010
Project Completion: Nov 2011
5. Suzlon Generators Ltd, Manufacturing Facility - Pune, India
• An engineering solution driven project of wind energy and other sectors generator
• Joint Venture program between Suzlon Group and ELIN EBG Motoren, Austria
• Facility is used for state-of-the-art varied sized hi-tech generators
• Synefra involved in complete, end to end, delivery from concept to commissioning
• Completed in a record time of 7 months
Data Sheet
Land Area: 8 acres
Built Area: 250,000 sq. ft.
Project Commencement: 2006
Project Completion: Nov. 2006
6. SE Electricals Ltd, Control Panel Unit - Coimbatore, India
• A Control Panel Assembly Unit for SE Electricals at Coimbatore
• The project was commissioned to be a dust-free climate controlled plant, for sensitive electrical
assemblies
• The plant included infrastructural features like 100% torque controlled assembly equipment, Climatic
Chamber for hot, cold & humidity tests and temperature rise & HV testing facilities
Data Sheet
Land Area: 33.50 acres
Built Area: 190,000 sq. ft.
Project Commencement: Feb 2008
Project Completion: May 2009
7. Suzlon Energy Ltd, Integrated Wind Component Manufacturing Unit -
Puducherry, India
• This integrated manufacturing facility at Puducherry is spread across 60 acres of land with a minimal
ecological footprint project
• 95% vegetation on site left untouched
• State-of-the-art industrial infrastructure
• Complete program management from concept to hand over by Synefra
Data Sheet
Land Area: 52 acres
Built Area: 500,000 sq. ft.
Project Commencement: Jan 2008
Project Completion: April 2009
9.SuzlonEnergyLtd,RotarBladeManufacturingFacility–Pipestone,USA
• A composite engineering product manufacturing facility
• Executed under extreme weather conditions of sub-zero temperatures
• Synefra provided all services from concept design to commissioning
• Completed and handed over project within stipulated time frame
8. SE Forge Ltd, Forging and Foundry Plant - Vadodara, India
• A 50 acre Forging and Foundry plant for SE Forge Ltd.
• Synefra commissioned the project within 20 months from the date of commencement
• Complex water drainage system incorporated to prevent flooding
• High quality of site infrastructure
Data Sheet
Land Area: 39.20 acres
Built Area: 215,000 sq. ft.
Project Commencement: Nov. 2005
Project Completion: July 2006
Data Sheet
Land Area: 40 acres
Built Area: 450,000 sq. ft.
Project Commencement: Aug 2007
Project Completion: May 2009

10. Suzlon Energy Ltd, Integrated Manufacturing Facility for Wind
Component - Tianjin, China
• Oneoftheworld’slargestIntegratedManufacturingfacilitiesforengineeringcomponents
• ProgrammanagedbySynefrainanindustrialarea
• Complete service delivery of project, including legal and statutory requirements as per local
govt. agency requirement
Data Sheet
Land Area: 62 acres
Built Area: 550,000 sq. ft.
Project Commencement: Jan 2006
Project Completion: April 2007
Completed Projects
Industrial Parks
1. Vadodara Industrial Park - Gujarat, India
• Close to the territorial limits of Vadodara Urban Development Authority (VUDA) on SH 158, the Synefra
Vadodara Industrial Park is just 7 km from NH 8. It is the only SEZ in the state with ready-to-use gas supply
infrastructure.
• Synefra, located at Waghodia has laid its own secured pipeline of 24 km for transmitting Liquified Natural
Gas
• Spread across an approximate area of 295 acres land, with an efficiency of over 80% and a dedicated
104 acres for non process areas, green cover and roads, Synefra has already leased out 57 acres to
hi-tech engineering companies from across the globe
• Synefra Infrastructures Ltd. coordinated the entire design & project management program from master
planning to commissioning
Data Sheet
Land Area: 295 acres
Built Area: NA
Project Commencement: Aug 2007
Project Completion: Mar 2009
2. Coimbatore Industrial Park - Tamil Nadu, India
• Located at Karumathampatti, within the territorial limits of Coimbatore, on SH 165 and just 1.5 Kms
from NH - 47 (Salem - Kanyakumari highway)
• The Synefra Coimbatore Inudstrial Park is the only fully functional SEZ with a 230 KV level power
station in India
• Spread across an approximate area of 376 acres with an efficiency of over 80% and a dedicated 104
acres for non process areas, green cover and roads, Synefra has already leased out 155 acres to
hi-tech engineering companies from across the globe
• Complete design and project management was handled by Synefra Infrastructures Ltd.
Data Sheet
Land Area: 376 acres
Built Area: NA
Project Commencement: Aug 2007
Project Completion: April 2009
3. Padubidri Industrial Park - Karnataka, India
• Close to the New Mangalore Port and adjacent to National Highway 17 which passes through
Maharashtra, Goa, Karnataka and Kerala, Synefra Padubidri Industrial Park is designed to provide
a Gateway to a Global Market, for easy export & import
• Spread across an approximate area of 641 acres with an efficiency of over 80% and a dedicated 210
acres for non process areas, green cover and roads
• Synefra has already leased out 120 acres to hi-tech engineering companies from across the globe
• Synefra Infrastructures Ltd. involved in the entire design and execution program from start to finish
Data Sheet
Land Area: 641 acres
Built Area: NA
Project Commencement: Feb 2007
Project Completion: May 2009
Ongoing Projects
2. GE India, Multimodal Manufacturing Facility - Pune, India
• Project includes Office Block, Manufacturing Building and Canteen along with all Infrastructure
including roads, STP and ETP
• Challenging undulating site
• Several value additions to infrastructure & building design from Synefra has resulted in substantial cost
savings for GE
• Scope of services includes peer review of Architectural drawings, cost management and complete
project & construction management
Data Sheet
Land Area: 75 acres
Built Area: 655,871 sq. ft.
Project Commencement: April 2012
Project Completion: Ongoing
1. Mercedes Benz India Ltd, Q3 Block Allied Structures - Pune, India
• Buildings include a Production hall, Office Building, Canteen, Energy building, Energy Bridge,
STP and Security Cabin
• Value Engineering done by Synefra
• Scope includes complete project management and construction management
Data Sheet
Land Area: 10 acres
Built Area: 500,000 sq. ft.
Project Commencement: Feb 2012
Project Completion: Ongoing
3. Alfa Laval, Master Plan, Design for Manufacturing facility - Pune,
India
• Phase 0 development work included excavation, leveling project compound walls and internal
infrastructural facilities
• Phase 1 consist of concept, design development programme management activities encompassing
manufacturing plants to be operational by Dec, 2015
• This will be largest manufacturing facility of Alfa Laval Group
Data Sheet
Land Area: 47 acres
Built Area: 200,000 sq. ft. (Approx.)
Project Commencement: August 2013
Project Completion: Ongoing
4. Tata Housing, Residential Project - Mumbai, India
• Tata Housing is high- end affordable residential development project comprising of towers, row houses
and non- programmed spaces
• Synefra's scope of work includes complete project management services
Data Sheet
Land Area: 41 acres (Approx.)
Built Area: 600,000 sq. ft.
Project Commencement: Jan 2014
Project Completion: Ongoing
5. Lupin Ltd, Research & Development Park - Pune, India
• Pharma Research & Development facility
• Consists of Laboratories, Office Spaces, Training Centre with support facilities including a Cafeteria
and an Auditorium
• Car-parking, surrounding landscaping & Infrastructure works included in Synefra’s scope
• Being an R&D centre, project includes setting up a zero discharge scheme in order not to pollute the
surrounding environment
• Synefra's experience and expertise in sustainable development enabling Lupin aim for LEED®
Gold Certification
• Synefra's scope of work includes complete project management services
Data Sheet
Land Area: 8 acres
Built Area: 300,000 sq. ft.
Project Commencement: May 2012
Project Completion: Ongoing
6. GE India, JFWTC (John F. Welch Technology Centre) -
Bangalore, India
• A brown field project which includes Multiple time bound projects
• Synefra is providing Project Management Consultancy Services for civil, structural, architectural, labs,
interior fit out & electro-mechanical services works
• Project commenced from June 2014
• Project area is entire campus for all the projects identified in three different verticals
- GEITC (GE India Technology Center)
- GEHC (GE Healthcare Center)
- GE Facility
• Synefra's scope of work is to act as the representative of GE and be responsible for the administration,
management and communication coordination of the projects. The scope of services broadly includes
coordination with end users, understanding owner's project requirement, tender support, assisting GE
for deployment of other Consultants, design management, planning & scheduling, construction
management ensuring statutory & EHS compliances and technical & commercial closure
7. Mercedes Benz India Ltd, QII Body Shop Project Expansion - Pune, India
• Expansion of QII shop including complete process structure and Utility structure
• Roads and internal services
• Landscape
• Related Service/Infrastructure facilities
• Expansion of Training bays at Customer at Training Centre
Data Sheet
Total Built up Area: 11,000 Sq. M.
Commencement date: October 2014
Project completion: Ongoing

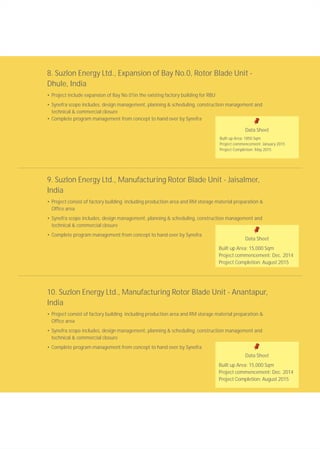

8. Suzlon Energy Ltd., Expansion of Bay No.0, Rotor Blade Unit -
Dhule, India
• Project include expansion of Bay No.01in the existing factory building for RBU
• Synefra scope includes, design management, planning & scheduling, construction management and
technical & commercial closure
• Complete program management from concept to hand over by Synefra
Data Sheet
Built up Area: 1850 Sqm
Project commencement: January 2015
Project Completion: May 2015
9. Suzlon Energy Ltd., Manufacturing Rotor Blade Unit - Jaisalmer,
India
• Project consist of factory building including production area and RM storage material preparation &
Office area
• Synefra scope includes, design management, planning & scheduling, construction management and
technical & commercial closure
• Complete program management from concept to hand over by Synefra
Data Sheet
Built up Area: 15,000 Sqm
Project commencement: Dec. 2014
Project Completion: August 2015
10. Suzlon Energy Ltd., Manufacturing Rotor Blade Unit - Anantapur,
India
• Project consist of factory building including production area and RM storage material preparation &
Office area
• Synefra scope includes, design management, planning & scheduling, construction management and
technical & commercial closure
• Complete program management from concept to hand over by Synefra
Data Sheet
Built up Area: 15,000 Sqm
Project commencement: Dec. 2014
Project Completion: August 2015
Synefra in the News
AwardforOneEarthproject
greenaward
MercedesBenzcontractforpaintshop
-TheEconomicTimes
Global Recognition
Site management in construction lacks integrated approach
‘GreenBuildingConcept’
Oureveryconstructionreflects
Synefrabagsprestigious
-CIA-WORLD
-DNA
-SakalTimes
- Project Info
- Afternoon
Consideringtheimpactontheenvironmentandecologyassociatedwithinfrastructuredevelopment,Synefra
isfocusedtowardstheoperationalizationofsustainableprinciplesintoalltheservicesprovided.
Synefrabelievesthatanintegratedsustainabilitysystemisachievedwhenthreeessentialaspects-economic,
social and environmental - are adequately balanced with one another. Synefra has today evolved to be an
innovative integrated solution provider for industrial and commercial infrastructure, with a commitment and
strongfocustowardssustainableandresponsibledevelopment.
ServicesofferedforGreenfieldProjects
1. SustainableMasterPlanning
• FacilitationfromConcepttoCommissioning
• Settingapathtoachievesustainability
• IncorporatingsustainabilityfeaturesinMasterPlanning
2. Design&EngineeringSolution
• DetailArchitecturalDesigningincludingBuildingEnvelop
• EnergyEfficientSolutions
• EfficientWaterManagementSolutions
• Waterefficientlandscape
• SolidWastemanagement
3. SustainableConstructionManagement
• Assistanceinpreparationofsustainableconstructionmanagementplan
• AssistanceinGreenMaterialprocurement
• Highperformancebuildingdesign
pioneering initiatives
4. GreenBuildingCertification
• Facilitation
• EnergySimulation&Analysis
• DayLighting
• ArtificialLighting
• BuildingEnvelop
• HVACsystem/Ventilationsystems
• WindAnalysis
• CoordinationforGreenBuilding
• BuildingCommissioning
5. RenewableEnergySolutions
• Feasibilitystudies
• DesigningAppropriatesystemsizing
• DesignofSystemIntegration
“Synefra’s costing was aptly perfect and there was good amount of detailing in the work. Cost analysis and excel backups
helped us to achieve the figure we intended. We saw enthusiasm and energy in the team. We thank Synefra for the great
support&lookforwardforsimilarsupporttoincompletingthisprojectsuccessfully.”
Mr. Palanganda Kuttappa (Leader Direct Sourcing, GE India)
“Synefra has worked meticulously in preparing the budgets, both for PEB & Main Package, and we are pleased with the
performance & efforts put by Synefra team. GE has complete faith and trust in Synefra team and sure of success in the project.
Budgeting&contractingworkwasfabulous.Mypersonalobservationis,Synefrateamisworkinglikeitistheirownproject.”
Mr. Srikant Srinivasan (Director, GE India)
“Synefra's proper understanding of our requirements with well defined project scope resulted in accurate planning of Project
timelines.Theirtechnicalexpertiseanddecadeoldexperiencehelpedinprojectscopeoptimization.”
Dr. Wilfried Aulbur, Mr. Schenker, Mr. Ganesh Dalvi, Mr. Uwe Jarosch (Mercedes Benz)
Suzlon One Earth is a great experience and this can be experienced only at this place. Kudos to the leadership team of the
ProjectManagementandallteammemberswhoareresponsibleforcreatingthisinfrastructure
Mr. Mahesh Ramanujam (COO, US Green Building Council)
Suzlon One Earth project by Synefra demonstrates tremendous thought process alongwith passion and strong execution.
Thishasledtoacreationofuniqueenvironmentinthissuperbcomplex.
Mr. Sanjiv Bajaj (Managing Director, Bajaj FinServ)
Suzlon One Earth is a treat to be experience and see all the innovative features incorporated into the design and execution. It is
well managed program with complete harmony of design, construction and operations and a case study for all that is possible
in green space infrastructure. I am sure that this will become a place that is emulated time and again to become a defining
buildingofthegreenbuildingmovementinIndia.
Dr. Ajay Mathur (Director General of the Bureau of Energy Efficiency (BEE))
Client Testimonials
I am pleased to put it on record Team Synefra’s professional,
dedication and hard work and integrity deliverance towards
our Multimodal Project at Chakan, Pune - India.
Mr. Bob Wilson,
(Manager Operations GE, United Kingdom)
“Suzlon One Earth is a wonderful execution of outstanding concepts.”
Mr. Azim Premji (Chairman, Wipro Ltd.)
SynefraInfrastructuresLtd.isaprofessionallymanagedcompanyleaningtowardsacustomer-centricapproach.Its
structureandorganizationalset-upisdesignedtoprovidethebestandmostreliableserviceatanoptimumprice.
The Central Knowledge & Operation Hub ensures process and technical support, thereby proving to be a great
value-add to clients. Timely and prompt action and delivery, clean and conducive work environment, a highly
motivatedworkforceandSPOCforallneeds,enablesSynefradeliverthebestandsurpassitscompetition.
With a collective experience of managing and developing more than 1400 acres of SEZinfrastructure; 2.5 million
sq. ft. of industrial projects; 1.5 million sq. ft. of commercial and office spaces across the world, Synefra has
garnered much praise and several awards for its achievements. With an in-house sustainability cell and in-depth
understandingofallprojectaspects,SynefraInfrastructuresLtd.isundoubtedlyaglobalforcetoreckonwith.
why Synefra
Suzlon One Earth, Suzlon Global HQ, Pune - India
Concept & Management by Synefra
GE India, Multimodal Manufacturing Facility, Pune - India
Program Management by Synefra
Synefra Infrastructures Ltd.
Godrej Millennium, 5th Floor, 9, Koregaon Park Road, Pune - 411001.
Tel: +91 20 66278000 / 25 | Fax: +91 20 67022100
Email: info@synefra.com | www.synefra.com

Synefra e-pm brochure for mail

  • 1.
  • 2.
    Synefra stands forSynergy in Infrastructure - an integrated synergized approach that defines and symbolizes every program of Synefra. The ‘E’ that binds Synergy & Infrastructure symbolizes our core business focus on Efficiency,Effectiveness,Excellence,EconomicsandEnvironment. Synefra Infrastructures Ltd. (A Tanti Group Company) formerly known as Suzlon Infrastructure Ltd., was establishedin1998 toconceptualize,invest,develop&maintainhi-techindustrialinfrastructureglobally. With a team of experienced professionals comprising of Engineers, Architects, Finance and Project Managementspecialists,Synefraoffersawidearrayofspecializedservicesin: • Architectural Design • Program Management • Building Engineering Design • Engineering Solutions • Sustainability Solutions • Construction Management e-PM (Excellence in Project Management) e-PM vertical of Synefra provides ‘concept to completion’ Project Management services to the infrastructure sector. Synefra’s experience in large scale projects in China, Europe, India and the USA make it an ideal project manager. The Project Management teams are trained and experienced in development and implementation of the best processes and systems customized to the client’s need, delivering the desired results and achievingtheprojectgoalsofTime,CostandScope. With more than a decade of cross-functional expertise, Synefra today has evolved as an Innovative Infrastructure Solutions provider to various business segments. Having successfully delivered over 150 projects globally, with a footprint of 1400 acres of SEZ development, building over 3 million sq. ft. of industrial spaces and more than 1.5 million sq. ft. of top class office spaces, campuses, R&D centres, Training & Learning academies and social infrastructure, Synefra is geared to deliver world classinfrastructuresolutionswithin-houseexpertise.
  • 3.
    about the team Asa company Synefra holds a track record of handling over 150 projects across the world, expanding over 4 continents, namely: Asia, China, Europe & USA. Synefra’s experience in handling major industrial projects has earnedaccoladesfornotonlyplanningconceptanditscompletion;butalsoundertakingfacilitymanagement servicesoncompletion. Our Project Control Group (PCG) supports Project Site Group (PSG) on various important aspects like: Project strategy; Administrative controls; Project procedure; Management Information System (MIS); Documentation control; Quality control; Environmental, Health & Safety for the client. The PCG also effectively handles Cost planning, Budget control, Cash inflows, Contractual schedules, Risk mitigation and Logisticsupport. Managing Director Mr. J.R. Tanti, is an architect by profession and a crusader for responsive and responsibleinfrastructurebychoice. With an experience of over 26 years, Mr. Tanti has commissioned large scale industrialprojectforwindenergyandvariousothersectors.Akeenlearner,he has consistently added to his repertoire of skills with practical innovations and handsonexperience. Having executed over 100 projects globally, Mr. Tanti has spearheaded three hi-tech engineering Special Economic Zones admeasuring over 1400 acres in three different Indian States which are fully operational and performing. The Suzlon One Earth project is a marvel project epitomizing green and sustainability values for Infrastructureandisgloballyacclaimed.ThisglobalHQofSuzlonGroupisoneofthelargestcorporatecampus in green and sustainable infrastructure, rated LEED Platinum and GRIHA five stars, a trend setting state of the artstructurewhichhassetmanybenchmarksintheinfrastructureindustry. Under Mr. Tanti's leadership, the company has developed and incorporated various initiatives like 'Sustainability & Responsibility', 'New & Relevant Technology' and 'Business Excellence' which have become intrinsic in day to day operations. Re-designing boundaries and expanding horizons are Mr. Tanti's hallmarks, whilehisdrivingforcesareinnovationandtechnologyoptimization. An entrepreneur with a vision, Mr. Tanti, is considered a champion for Green building Initiatives and his projects have always focused and reflected environmentallyresponsible architecture adhering to values like --- energy efficiency, environmentconscious,neighborhoodenhancementandsocialresponsibility. J.R. TANTI
  • 4.
    PHILOSOPHY What differentiates Synefrafrom regular brick and mortar services provided by infrastructure solution providers? It is our philosophy! A philosophy that stems from our core values of knowledge and quality; creatingconstantchallengestobetterourselvesandproviding‘earth-friendly’solutions. Wearenot justabout theexecution,but the‘thinking’behindit.AtSynefra,ourthinking,rightfrominception is inclined towards overcoming challenges. In the field of infrastructure, as in life, the word ‘impossible’ is actuallyan‘opportunity’toexplorepotentialsandtestcapabilities. With our core competencies like Conceptualization, Design Development, Engineering Innovations, Project ManagementTechnologyApplication, wehavechallengedeachquestionthatwehavefacedwithandreplied successfullywhilecreatingbenchmarkprojectsforourclients. Challenge us, our business verticals are our pillars of strength, have never let us down. We are Synefra, and challengesarewhatkeepusgoing. VISION We will be an Industry Leader in Design Engineering, Construction and Services providing Total Quality and Cost-Effective Integrated Solutions on time, setting industry benchmarks, achieving customer satisfaction anddedicatedtosustainabledevelopment. We will continually work towards employee development by providing a conducive work environment that empowersthroughknowledgeandinnovation.
  • 5.
    Synefra Infrastructures Ltd.is poised to provide quality services at optimum costs by way of continuous processimprovementforbothcustomersaswellasitsemployees. Ourresponsibilityistoensurethatthoroughestablishedstandardsandproceduresarebeingfollowedsothat thelevelofqualitymatches,orevenexceeds,thecustomer'sexpectations. We develop quality awareness through continuous process improvement and imparting training to our employeesperiodically.Qualityisanintegralpartofourcommitmenttoworldclassservices. OurqualityprocessIncludes: • Verifyingandvalidatingbothexistingaswellasnewprogramfunctions • Researchimprovementstoaddtothequalityofourservices • Helpingtodefineandimproveourservicesthroughinvolvementwithouremployeesandourcustomers • Conducting internal quality audits and management review for our ongoing evaluation and improvement ofourqualitysystem • Verifyandvalidatetheprocessesandproceduresofvariousservicesbeforeitreachesthecustomer Y PT OIL LA ICU YQ
  • 6.
    The'e'ine-PMrepresentsthestrongdesirewithinourcompanytostriveforexcellence. Excellence-Efficacy-Engineering-Engagement-Effectiveness-Efficiency-Edge-Energy e-PMoperatesdeployinginternationallyacceptedstandardsincluding: • ISO 9001:2008for Quality • ISO 14001:2004 for Environment • OHSAS 18001:2007 for Safety Our teams carry wealth of knowledge and experience in operating under various geographical, cultural, political and financial environments. Past projects have been located in USA, China, Europe and Asia, wherein sub-zero temperatures, time zones, language barriers,logisticsandcoordinationissueshaveallbeensuccessfullynegotiated. our esteemed clients
  • 7.
    We also offertask-oriented services customized to client needs like: • Technical due diligence/feasibility study • Third Party Audits • Cost Management & Quantity Survey • Quality Management Process Set up Project Management Project Monitoring Construction Management Design Management Green Building Consultancy & Certification CLOSE OUTMONITORING & CONTROLEXECUTIONPLANNINGINITIATION We have developed a team of professionally qualified people who bring in rich and diverse skill sets and experience from the industry. Thus a unique e-PM service delivery model has been designed, keeping our clients and their requirements in the centre. The project management teams at Synefra are backed by a real-time knowledge hub, which acts as a project control group.
  • 8.
    Activities • Establish designsign off process and delivery • Identify information gaps • Value Management • Identify environmental and sustainability targets • Monitor design progress deliverables • Design coordination • Develop Contractor selection and appointment process • Implement Design Change Control Deliverables • Design Basis Reports (By Design Team) • Procurement Strategy • Preliminary cost plans at each stage (pre-tender estimate) • Revised Design Brief (Sign Off) • Design Sign of • Sign Off Budgets Activities • Develop Strategy • Compile Bid Document • Vendor Pre-qualification • Issue Bid Package • Identify long lead items • Conduct Bidding Process • Technical and commercial negotiations Deliverables • Tender documentation • Bid Evaluation & Recommendation • Reports • Contracts/PO ASSESS DEVELOP scope of Pre - ConstructionDesign & Development
  • 9.
    Activities • Site logistics,planning and mobilisation • Construction Supervision • Contract Administration • Change Management • Monitoring of construction against cost and program and expectations • Testing and Commissioning • Prepare H&S File and O&M’s • Migration Planning • Completion of works and Handover Deliverables • Construction Program Reports • Cost Reports • Invoice Certifications • Change Orders • Deviations DELIVER Construction services
  • 10.
    geographies Synefra Infrastructures Ltd.works primarily in Gujarat, Maharashtra, Karnataka & Tamil Nadu. Our network of offices and partners allows for quick and easy mobilization turn-around time, which benefits our clients in early mobilization and project initiation. LEGEND Head Office Registered Office Offices Project Offices Ahmadabad Pune KARNATAKA TAMIL NADU MAHARASHTRA GUJARAT Bangalore Chennai MADHYA PRADESH RAJASTHAN GOA ANDHRA PRADESH DELHI Chakan Padubidri Karumathampatti Waghodia Mumbai Coimbatore Jaipur Jodhpur IndoreRajkot Hyderabad Panjim New Delhi
  • 11.
    Completed Projects A. CorporateOffices B.Industrial&ManufacturingProjects C. IndustrialParks
  • 12.
    1.SuzlonEnergyLtd,SuzlonOneEarth-Pune,India GlobalHeadQuartersofSuzlonGroup Abenchmarkproject in greenandsustainableinfrastructurespread across 10acreswitha builtup of approx.820,000 sq. ft. This corporate campus which is the global headquarters of Suzlon Energy Ltd. at Pune, is heralded as a world acclaimedgreenbuildingincompletealignmentwiththeclient’smissionof‘PoweringaGreenerTomorrow,Today.’ Suzlon One Earth, a project conceived, managed and executed by Synefra. was recently awarded as the Regional WinnerinAsiaPacific,inthecategoryof“BestOfficeDevelopment”attheInternationalPropertyAwards2011. Suzlon One Earth has highest ratings from both LEED India and GRIHA. It achieved Leed Platinum Certification with 57 pointsfor‘BuildingintheNewConstruction'categoryand GRIHA-5starcertificationratingwith96points. SuzlonExcellenceAcademy Within Suzlon One Earth campus is a dedicated 1,00,000 sq. ft. Learning & Development academy with 7 learning spaces, a theatre, a library, an amphitheatre, wind gallery, meeting rooms, offices & business halls that are fully equipped with state of the art technology and infrastructure. Data Sheet Land Area: 10 Acres Built Area: 820,000 sq. ft. Project Commencement: April 2006 Project Completion: Dec 2009
  • 13.
    2. SE CompositesLtd, Office Facility - Padubidri, India • Thisprojectconsistingof80,000sq.ft.,wasconceivedastheglobalheadquartersforSECLCompositesLtd. • Part of an industrial development of 67 acres - a production facility for Rotor Blades for wind turbine generators • ConceivedanddesignedtocatertoallSECL’sbusinessheads • Designedonsustainabilityprinciples Data Sheet Land Area: 2 Acres Built Area: 80,000 sq. ft. Project Commencement: June 2008 Project Completion: NA 3.SuzlonEnergyLtd,CECAdministrativeBuilding-Vadodara,India • TheprojectwasconceivedastheadministrativecenterforCEC,SuzlonEnergyLtd. • ThebuildingwasconceivedanddesignedtocatertoCEC’sR&D,AdministrativeandTrainingneeds • Synefraresponsibleforentireprojectprocess,fromarchitecturaldesigntohandover • Multiplegreenbuilding&sustainableprinciplesincorporatedintothebuildingdesign Data Sheet Land Area: 2 acres Built Area: 75,000 sq. ft. Project Commencement: Dec 2003 Project Completion: NA 4. Suzlon Wind International Ltd, - Padubidri, India • Part of an industrial development of 67 acres - a production facility for assembly of wind turbine generators • Conceived and designed as the global head-quarters for SWIL to cater to all their business heads • Designed on sustainability principles Data Sheet Land Area: 2 acres Built Area: 100,000 sq. ft. Project Commencement: Jan 2008 Project Completion: NA
  • 14.
    5.SuzlonEnergyLtd,AdministrativeOffice-Tianjin,China • Administration officesand Technology center for Suzlon Energy Tianjin Ltd, China. Two administrative officebuildingsandatechnologycenterwereestablishedwithanareaof30,000sq.ft.each • Developedasaclusterof3high-techbuildingstocatertoadministrative,technicalandR&Dfunctions • Designedandbuilttooptimizenaturallightandaccesstoexternalview Data Sheet Land Area: 5 acres Built Area: 90,000 sq. ft. Project Commencement: Jan 2006 Project Completion: April 2007
  • 15.
    6. Suzlon EnergyLtd, Administrative and Corporate Office Block - Puducherry, India • A part of 60 acres of pristine land; minimal ecological footprint project • Office to cater to administrative and technical functions for WTG integrated manufacturing hub • Designed and developed on sustainability principles - optimizing natural light, ventilation in common areas with introduction of verandahs and courtyards • It also comprises of a guest house facility Data Sheet Land Area: 4 acres Built Area: 60,000 sq.ft. Project Commencement: April 2003 Project Completion: Dec 2003
  • 16.
    Completed Projects Industrial &Manufacturing Projects
  • 17.
    1. Mercedes BenzIndia Ltd, City Bus Project – Pune, India • Concept to commissioning of 100,000 sq. ft. manufacturing facility • Installation of CO and LPG banks, Sewage and Water Treatment Plants2 • All Infrastructure development • Project completed within baseline schedule and costs • Synefra responsible for complete project management, cost management and construction management process Data Sheet Land Area: 3.5 acres Built Area: 100,000 sq. ft. Project Commencement: July 2010 Project Completion: Feb 2011
  • 18.
    2.MercedesBenzIndiaLtd,PaintShop-Pune,India • CompletePaintShopprojectmanagement • Valueengineering&peerreviewofdesignincludingstudyingandunderstandingprocessflow •Infrastructuredevelopmentoffull50acres • CompleteProgrammanagementservicesbySynefra Data Sheet Land Area: 3 acres Built Area: 200,000 sq. ft. Project Commencement: Apr 2011 Project Completion: July 2012 3. Volkswagen, Process & Utility Structures - Pune, India • Scope included project managing the construction of Central Kitchen, Logistic Hall Ware house, CKD Warehouse and Sales and Service Training Centre • Synefra’s services included design management, Contracts, Procurement, Planning and Scheduling, Construction Management, Cost Management, Documentation, Quality Control and Handover and Transition Management • Synefra's involvement was from concept to completion and hand over Data Sheet Land Area: 7.5 acres Built Area: 250,000 sq. ft. Project Commencement: Oct 2011 Project Completion: Dec 2012
  • 19.
    4.SerumInstituteofIndiaLtd,OperationsUpgrade-Pune,India PhaseI: • Analysis andrecommendations on improvements in prevalent operations viz electrical, HVAC, waste water, rainwaterharvestingandsolidwastemanagement PhaseII: • Oversee and manage detailed designed development, engineering and construction aspects for Briquette FiredboilerSEZBio-TechServicesPvt.Ltd. • Installationof‘BiomassBriquetteFiredBoiler’forsteamgeneration • SubstantialreductioninGreenHouseGasemission • UseofBriquettesfromcropresidue Data Sheet Land Area: 5 acres Built Area: NA Project Commencement: Nov 2010 Project Completion: Nov 2011 5. Suzlon Generators Ltd, Manufacturing Facility - Pune, India • An engineering solution driven project of wind energy and other sectors generator • Joint Venture program between Suzlon Group and ELIN EBG Motoren, Austria • Facility is used for state-of-the-art varied sized hi-tech generators • Synefra involved in complete, end to end, delivery from concept to commissioning • Completed in a record time of 7 months Data Sheet Land Area: 8 acres Built Area: 250,000 sq. ft. Project Commencement: 2006 Project Completion: Nov. 2006
  • 20.
    6. SE ElectricalsLtd, Control Panel Unit - Coimbatore, India • A Control Panel Assembly Unit for SE Electricals at Coimbatore • The project was commissioned to be a dust-free climate controlled plant, for sensitive electrical assemblies • The plant included infrastructural features like 100% torque controlled assembly equipment, Climatic Chamber for hot, cold & humidity tests and temperature rise & HV testing facilities Data Sheet Land Area: 33.50 acres Built Area: 190,000 sq. ft. Project Commencement: Feb 2008 Project Completion: May 2009 7. Suzlon Energy Ltd, Integrated Wind Component Manufacturing Unit - Puducherry, India • This integrated manufacturing facility at Puducherry is spread across 60 acres of land with a minimal ecological footprint project • 95% vegetation on site left untouched • State-of-the-art industrial infrastructure • Complete program management from concept to hand over by Synefra Data Sheet Land Area: 52 acres Built Area: 500,000 sq. ft. Project Commencement: Jan 2008 Project Completion: April 2009
  • 21.
    9.SuzlonEnergyLtd,RotarBladeManufacturingFacility–Pipestone,USA • A compositeengineering product manufacturing facility • Executed under extreme weather conditions of sub-zero temperatures • Synefra provided all services from concept design to commissioning • Completed and handed over project within stipulated time frame 8. SE Forge Ltd, Forging and Foundry Plant - Vadodara, India • A 50 acre Forging and Foundry plant for SE Forge Ltd. • Synefra commissioned the project within 20 months from the date of commencement • Complex water drainage system incorporated to prevent flooding • High quality of site infrastructure Data Sheet Land Area: 39.20 acres Built Area: 215,000 sq. ft. Project Commencement: Nov. 2005 Project Completion: July 2006 Data Sheet Land Area: 40 acres Built Area: 450,000 sq. ft. Project Commencement: Aug 2007 Project Completion: May 2009
  • 22.
    10. Suzlon EnergyLtd, Integrated Manufacturing Facility for Wind Component - Tianjin, China • Oneoftheworld’slargestIntegratedManufacturingfacilitiesforengineeringcomponents • ProgrammanagedbySynefrainanindustrialarea • Complete service delivery of project, including legal and statutory requirements as per local govt. agency requirement Data Sheet Land Area: 62 acres Built Area: 550,000 sq. ft. Project Commencement: Jan 2006 Project Completion: April 2007
  • 23.
  • 24.
    1. Vadodara IndustrialPark - Gujarat, India • Close to the territorial limits of Vadodara Urban Development Authority (VUDA) on SH 158, the Synefra Vadodara Industrial Park is just 7 km from NH 8. It is the only SEZ in the state with ready-to-use gas supply infrastructure. • Synefra, located at Waghodia has laid its own secured pipeline of 24 km for transmitting Liquified Natural Gas • Spread across an approximate area of 295 acres land, with an efficiency of over 80% and a dedicated 104 acres for non process areas, green cover and roads, Synefra has already leased out 57 acres to hi-tech engineering companies from across the globe • Synefra Infrastructures Ltd. coordinated the entire design & project management program from master planning to commissioning Data Sheet Land Area: 295 acres Built Area: NA Project Commencement: Aug 2007 Project Completion: Mar 2009
  • 25.
    2. Coimbatore IndustrialPark - Tamil Nadu, India • Located at Karumathampatti, within the territorial limits of Coimbatore, on SH 165 and just 1.5 Kms from NH - 47 (Salem - Kanyakumari highway) • The Synefra Coimbatore Inudstrial Park is the only fully functional SEZ with a 230 KV level power station in India • Spread across an approximate area of 376 acres with an efficiency of over 80% and a dedicated 104 acres for non process areas, green cover and roads, Synefra has already leased out 155 acres to hi-tech engineering companies from across the globe • Complete design and project management was handled by Synefra Infrastructures Ltd. Data Sheet Land Area: 376 acres Built Area: NA Project Commencement: Aug 2007 Project Completion: April 2009
  • 26.
    3. Padubidri IndustrialPark - Karnataka, India • Close to the New Mangalore Port and adjacent to National Highway 17 which passes through Maharashtra, Goa, Karnataka and Kerala, Synefra Padubidri Industrial Park is designed to provide a Gateway to a Global Market, for easy export & import • Spread across an approximate area of 641 acres with an efficiency of over 80% and a dedicated 210 acres for non process areas, green cover and roads • Synefra has already leased out 120 acres to hi-tech engineering companies from across the globe • Synefra Infrastructures Ltd. involved in the entire design and execution program from start to finish Data Sheet Land Area: 641 acres Built Area: NA Project Commencement: Feb 2007 Project Completion: May 2009
  • 27.
  • 28.
    2. GE India,Multimodal Manufacturing Facility - Pune, India • Project includes Office Block, Manufacturing Building and Canteen along with all Infrastructure including roads, STP and ETP • Challenging undulating site • Several value additions to infrastructure & building design from Synefra has resulted in substantial cost savings for GE • Scope of services includes peer review of Architectural drawings, cost management and complete project & construction management Data Sheet Land Area: 75 acres Built Area: 655,871 sq. ft. Project Commencement: April 2012 Project Completion: Ongoing 1. Mercedes Benz India Ltd, Q3 Block Allied Structures - Pune, India • Buildings include a Production hall, Office Building, Canteen, Energy building, Energy Bridge, STP and Security Cabin • Value Engineering done by Synefra • Scope includes complete project management and construction management Data Sheet Land Area: 10 acres Built Area: 500,000 sq. ft. Project Commencement: Feb 2012 Project Completion: Ongoing
  • 29.
    3. Alfa Laval,Master Plan, Design for Manufacturing facility - Pune, India • Phase 0 development work included excavation, leveling project compound walls and internal infrastructural facilities • Phase 1 consist of concept, design development programme management activities encompassing manufacturing plants to be operational by Dec, 2015 • This will be largest manufacturing facility of Alfa Laval Group Data Sheet Land Area: 47 acres Built Area: 200,000 sq. ft. (Approx.) Project Commencement: August 2013 Project Completion: Ongoing 4. Tata Housing, Residential Project - Mumbai, India • Tata Housing is high- end affordable residential development project comprising of towers, row houses and non- programmed spaces • Synefra's scope of work includes complete project management services Data Sheet Land Area: 41 acres (Approx.) Built Area: 600,000 sq. ft. Project Commencement: Jan 2014 Project Completion: Ongoing
  • 30.
    5. Lupin Ltd,Research & Development Park - Pune, India • Pharma Research & Development facility • Consists of Laboratories, Office Spaces, Training Centre with support facilities including a Cafeteria and an Auditorium • Car-parking, surrounding landscaping & Infrastructure works included in Synefra’s scope • Being an R&D centre, project includes setting up a zero discharge scheme in order not to pollute the surrounding environment • Synefra's experience and expertise in sustainable development enabling Lupin aim for LEED® Gold Certification • Synefra's scope of work includes complete project management services Data Sheet Land Area: 8 acres Built Area: 300,000 sq. ft. Project Commencement: May 2012 Project Completion: Ongoing
  • 31.
    6. GE India,JFWTC (John F. Welch Technology Centre) - Bangalore, India • A brown field project which includes Multiple time bound projects • Synefra is providing Project Management Consultancy Services for civil, structural, architectural, labs, interior fit out & electro-mechanical services works • Project commenced from June 2014 • Project area is entire campus for all the projects identified in three different verticals - GEITC (GE India Technology Center) - GEHC (GE Healthcare Center) - GE Facility • Synefra's scope of work is to act as the representative of GE and be responsible for the administration, management and communication coordination of the projects. The scope of services broadly includes coordination with end users, understanding owner's project requirement, tender support, assisting GE for deployment of other Consultants, design management, planning & scheduling, construction management ensuring statutory & EHS compliances and technical & commercial closure 7. Mercedes Benz India Ltd, QII Body Shop Project Expansion - Pune, India • Expansion of QII shop including complete process structure and Utility structure • Roads and internal services • Landscape • Related Service/Infrastructure facilities • Expansion of Training bays at Customer at Training Centre Data Sheet Total Built up Area: 11,000 Sq. M. Commencement date: October 2014 Project completion: Ongoing
  • 32.
    8. Suzlon EnergyLtd., Expansion of Bay No.0, Rotor Blade Unit - Dhule, India • Project include expansion of Bay No.01in the existing factory building for RBU • Synefra scope includes, design management, planning & scheduling, construction management and technical & commercial closure • Complete program management from concept to hand over by Synefra Data Sheet Built up Area: 1850 Sqm Project commencement: January 2015 Project Completion: May 2015 9. Suzlon Energy Ltd., Manufacturing Rotor Blade Unit - Jaisalmer, India • Project consist of factory building including production area and RM storage material preparation & Office area • Synefra scope includes, design management, planning & scheduling, construction management and technical & commercial closure • Complete program management from concept to hand over by Synefra Data Sheet Built up Area: 15,000 Sqm Project commencement: Dec. 2014 Project Completion: August 2015 10. Suzlon Energy Ltd., Manufacturing Rotor Blade Unit - Anantapur, India • Project consist of factory building including production area and RM storage material preparation & Office area • Synefra scope includes, design management, planning & scheduling, construction management and technical & commercial closure • Complete program management from concept to hand over by Synefra Data Sheet Built up Area: 15,000 Sqm Project commencement: Dec. 2014 Project Completion: August 2015
  • 33.
    Synefra in theNews AwardforOneEarthproject greenaward MercedesBenzcontractforpaintshop -TheEconomicTimes Global Recognition Site management in construction lacks integrated approach ‘GreenBuildingConcept’ Oureveryconstructionreflects Synefrabagsprestigious -CIA-WORLD -DNA -SakalTimes - Project Info - Afternoon
  • 34.
    Consideringtheimpactontheenvironmentandecologyassociatedwithinfrastructuredevelopment,Synefra isfocusedtowardstheoperationalizationofsustainableprinciplesintoalltheservicesprovided. Synefrabelievesthatanintegratedsustainabilitysystemisachievedwhenthreeessentialaspects-economic, social and environmental- are adequately balanced with one another. Synefra has today evolved to be an innovative integrated solution provider for industrial and commercial infrastructure, with a commitment and strongfocustowardssustainableandresponsibledevelopment. ServicesofferedforGreenfieldProjects 1. SustainableMasterPlanning • FacilitationfromConcepttoCommissioning • Settingapathtoachievesustainability • IncorporatingsustainabilityfeaturesinMasterPlanning 2. Design&EngineeringSolution • DetailArchitecturalDesigningincludingBuildingEnvelop • EnergyEfficientSolutions • EfficientWaterManagementSolutions • Waterefficientlandscape • SolidWastemanagement 3. SustainableConstructionManagement • Assistanceinpreparationofsustainableconstructionmanagementplan • AssistanceinGreenMaterialprocurement • Highperformancebuildingdesign pioneering initiatives
  • 35.
    4. GreenBuildingCertification • Facilitation •EnergySimulation&Analysis • DayLighting • ArtificialLighting • BuildingEnvelop • HVACsystem/Ventilationsystems • WindAnalysis • CoordinationforGreenBuilding • BuildingCommissioning 5. RenewableEnergySolutions • Feasibilitystudies • DesigningAppropriatesystemsizing • DesignofSystemIntegration
  • 36.
    “Synefra’s costing wasaptly perfect and there was good amount of detailing in the work. Cost analysis and excel backups helped us to achieve the figure we intended. We saw enthusiasm and energy in the team. We thank Synefra for the great support&lookforwardforsimilarsupporttoincompletingthisprojectsuccessfully.” Mr. Palanganda Kuttappa (Leader Direct Sourcing, GE India) “Synefra has worked meticulously in preparing the budgets, both for PEB & Main Package, and we are pleased with the performance & efforts put by Synefra team. GE has complete faith and trust in Synefra team and sure of success in the project. Budgeting&contractingworkwasfabulous.Mypersonalobservationis,Synefrateamisworkinglikeitistheirownproject.” Mr. Srikant Srinivasan (Director, GE India) “Synefra's proper understanding of our requirements with well defined project scope resulted in accurate planning of Project timelines.Theirtechnicalexpertiseanddecadeoldexperiencehelpedinprojectscopeoptimization.” Dr. Wilfried Aulbur, Mr. Schenker, Mr. Ganesh Dalvi, Mr. Uwe Jarosch (Mercedes Benz) Suzlon One Earth is a great experience and this can be experienced only at this place. Kudos to the leadership team of the ProjectManagementandallteammemberswhoareresponsibleforcreatingthisinfrastructure Mr. Mahesh Ramanujam (COO, US Green Building Council) Suzlon One Earth project by Synefra demonstrates tremendous thought process alongwith passion and strong execution. Thishasledtoacreationofuniqueenvironmentinthissuperbcomplex. Mr. Sanjiv Bajaj (Managing Director, Bajaj FinServ) Suzlon One Earth is a treat to be experience and see all the innovative features incorporated into the design and execution. It is well managed program with complete harmony of design, construction and operations and a case study for all that is possible in green space infrastructure. I am sure that this will become a place that is emulated time and again to become a defining buildingofthegreenbuildingmovementinIndia. Dr. Ajay Mathur (Director General of the Bureau of Energy Efficiency (BEE)) Client Testimonials I am pleased to put it on record Team Synefra’s professional, dedication and hard work and integrity deliverance towards our Multimodal Project at Chakan, Pune - India. Mr. Bob Wilson, (Manager Operations GE, United Kingdom) “Suzlon One Earth is a wonderful execution of outstanding concepts.” Mr. Azim Premji (Chairman, Wipro Ltd.)
  • 37.
    SynefraInfrastructuresLtd.isaprofessionallymanagedcompanyleaningtowardsacustomer-centricapproach.Its structureandorganizationalset-upisdesignedtoprovidethebestandmostreliableserviceatanoptimumprice. The Central Knowledge& Operation Hub ensures process and technical support, thereby proving to be a great value-add to clients. Timely and prompt action and delivery, clean and conducive work environment, a highly motivatedworkforceandSPOCforallneeds,enablesSynefradeliverthebestandsurpassitscompetition. With a collective experience of managing and developing more than 1400 acres of SEZinfrastructure; 2.5 million sq. ft. of industrial projects; 1.5 million sq. ft. of commercial and office spaces across the world, Synefra has garnered much praise and several awards for its achievements. With an in-house sustainability cell and in-depth understandingofallprojectaspects,SynefraInfrastructuresLtd.isundoubtedlyaglobalforcetoreckonwith. why Synefra
  • 38.
    Suzlon One Earth,Suzlon Global HQ, Pune - India Concept & Management by Synefra
  • 39.
    GE India, MultimodalManufacturing Facility, Pune - India Program Management by Synefra
  • 40.
    Synefra Infrastructures Ltd. GodrejMillennium, 5th Floor, 9, Koregaon Park Road, Pune - 411001. Tel: +91 20 66278000 / 25 | Fax: +91 20 67022100 Email: info@synefra.com | www.synefra.com
