Team #1Gerardo Trevino Jeremy HalbardierJavier GuerreroOlakunleSosanyaDC DISTRUBUTION CONTROLLERSTATUS REPORT #42/1/2010

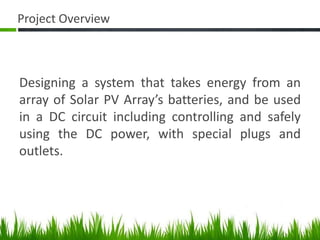

Project OverviewDesigning a system that takes energy from an array of Solar PV Array’s batteries, and be used in a DC circuit including controlling and safely using the DC power, with special plugs and outlets.

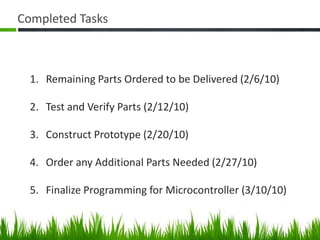

Completed TasksRemaining Parts Ordered to be Delivered (2/6/10) Test and Verify Parts (2/12/10)Construct Prototype (2/20/10)Order any Additional Parts Needed (2/27/10)Finalize Programming for Microcontroller (3/10/10)

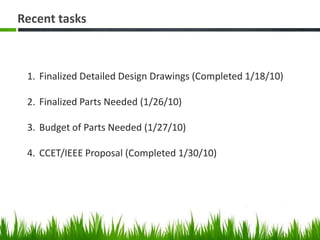

Recent tasksFinalized Detailed Design Drawings (Completed 1/18/10)Finalized Parts Needed (1/26/10)Budget of Parts Needed (1/27/10)CCET/IEEE Proposal (Completed 1/30/10)

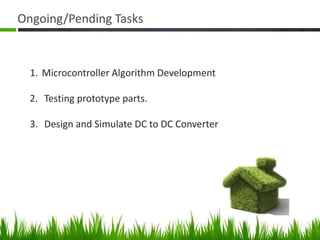

Ongoing/Pending TasksMicrocontroller Algorithm Development  Testing prototype parts. Design and Simulate DC to DC Converter

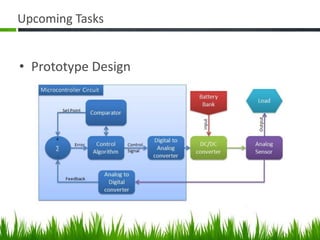

Upcoming TasksPrototype Design

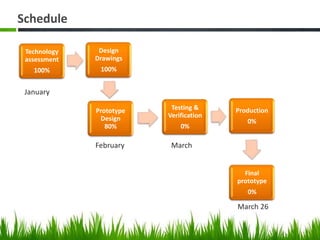

ScheduleJanuaryFebruaryMarchMarch 26
Project Timeline
Questions
DC to DC

Status report #4
