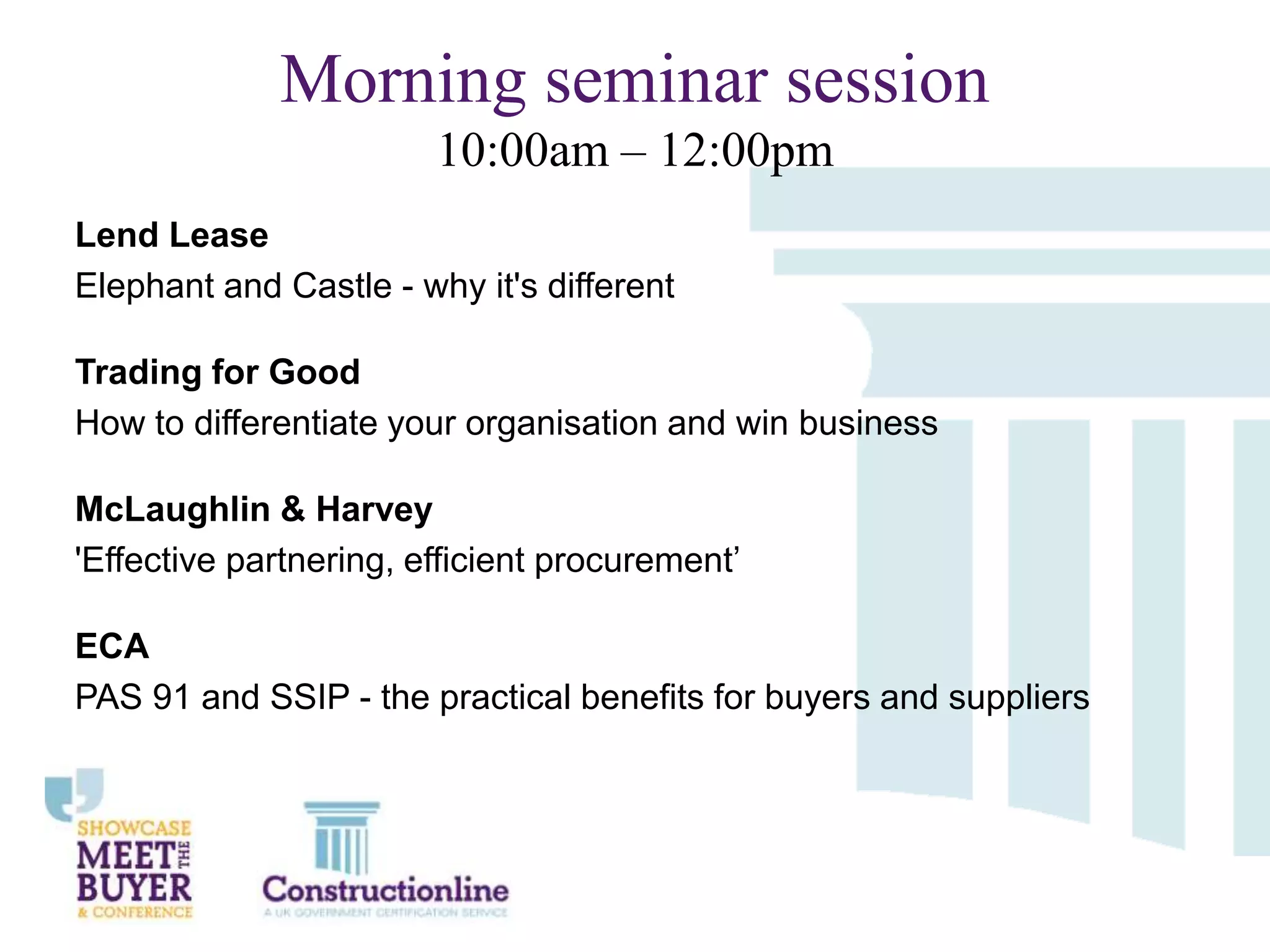

Morning seminar session
10:00am – 12:00pm
Lend Lease
Elephant and Castle - why it's different
Trading for Good
How to differentiate your organisation and win business
McLaughlin & Harvey
'Effective partnering, efficient procurement’
ECA
PAS 91 and SSIP - the practical benefits for buyers and suppliers

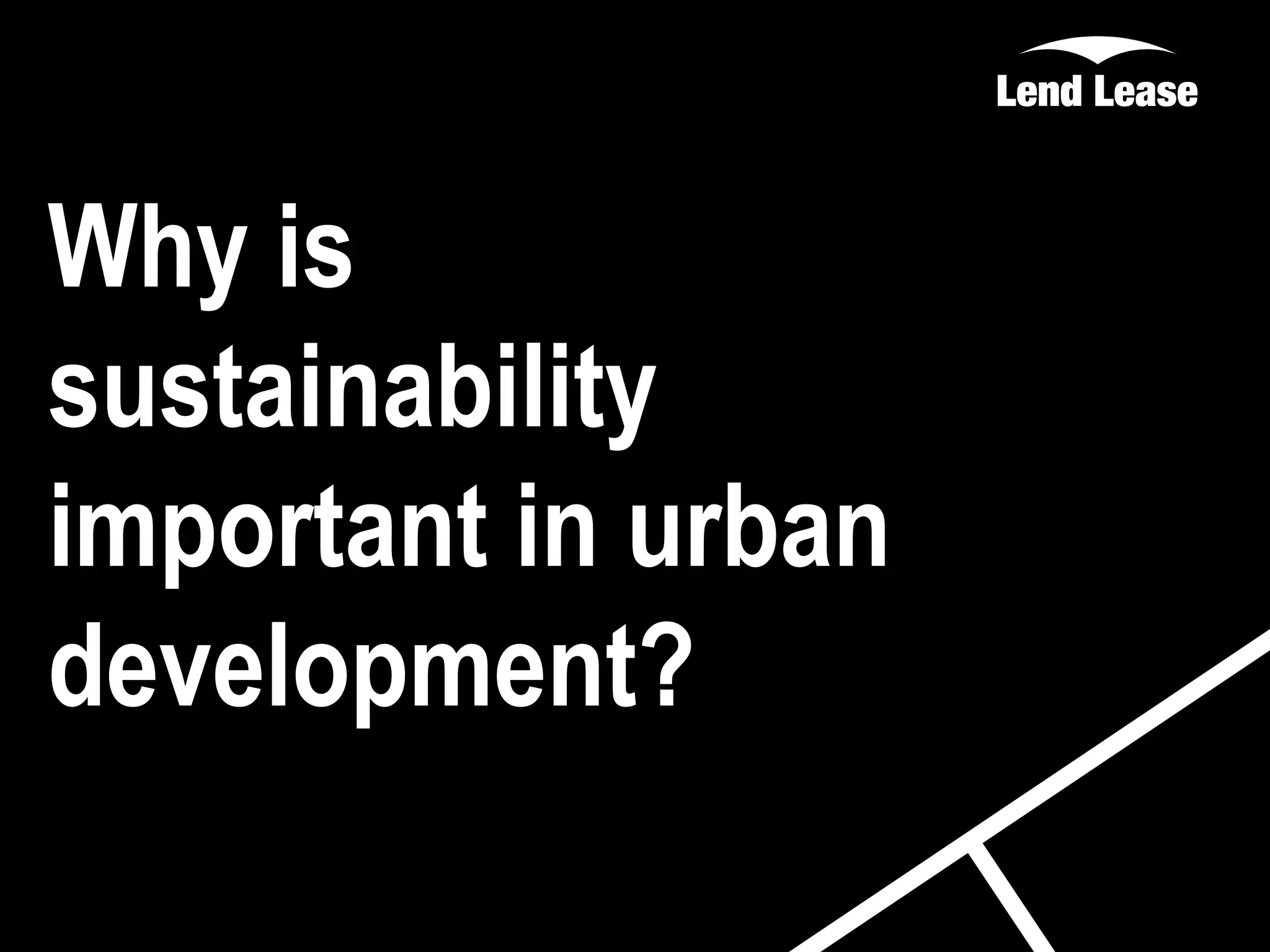

The Elephant and Castle - why it is different
Why is
sustainability
important in urban
development?

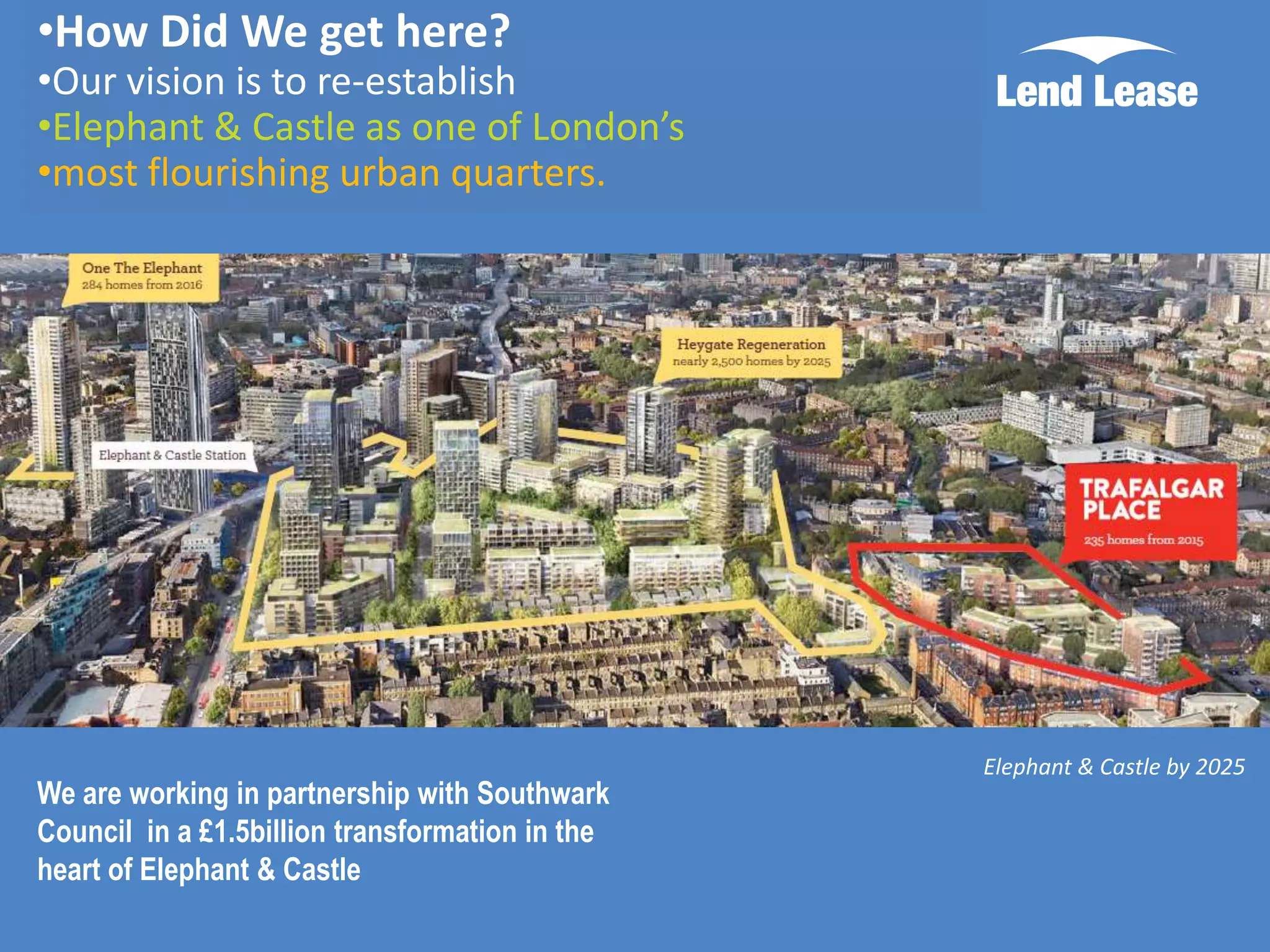

•How Did We get here?

•Our vision is to re-establish
•Elephant & Castle as one of London’s
•most flourishing urban quarters.

We are working in partnership with Southwark
Council in a £1.5billion transformation in the
heart of Elephant & Castle

Elephant & Castle by 2025

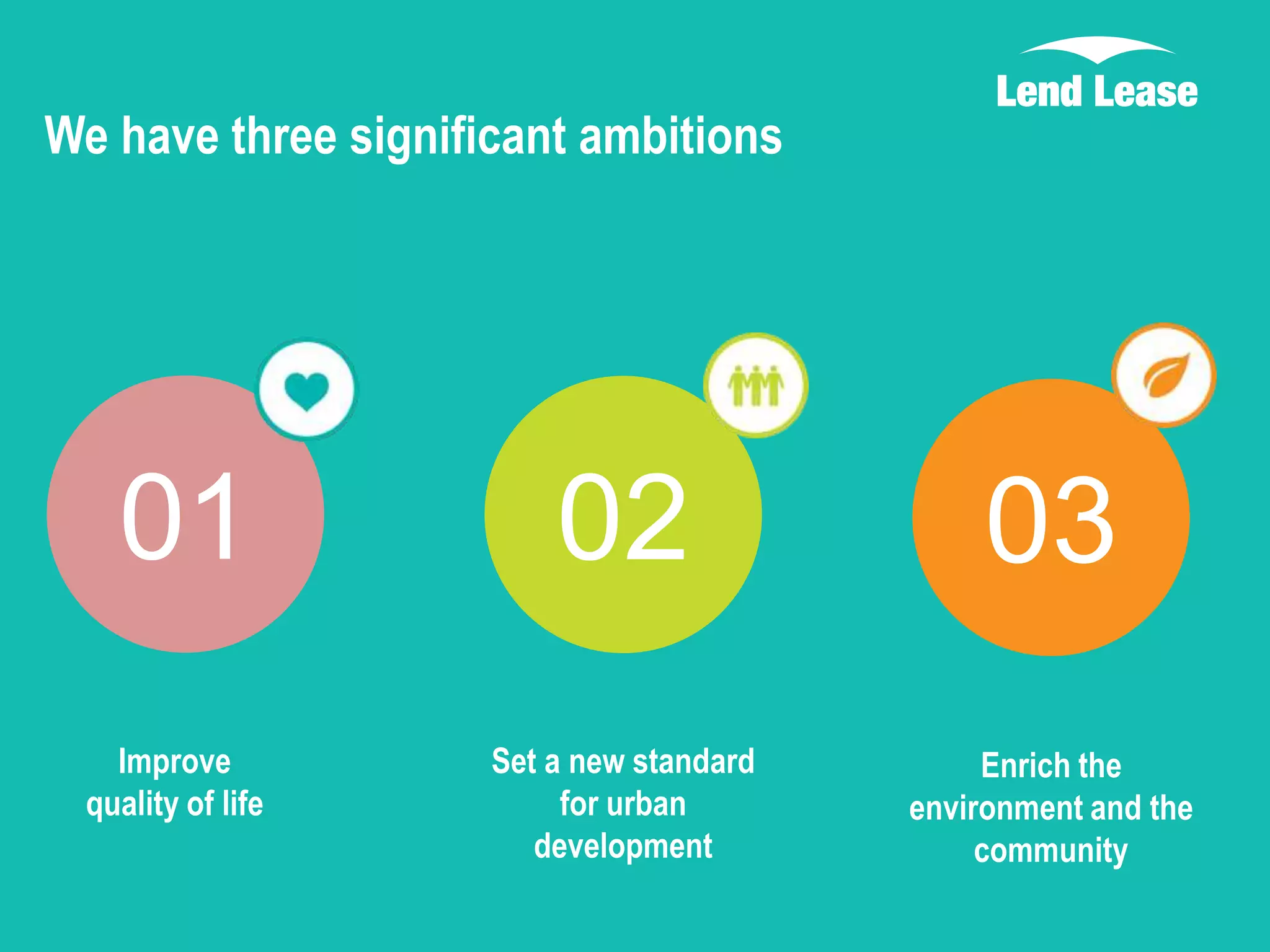

We have three significant ambitions

01
Improve
quality of life

02

03

Set a new standard
for urban
development

Enrich the
environment and the
community
Part of the
Clinton Climate
Positive
Development
Program

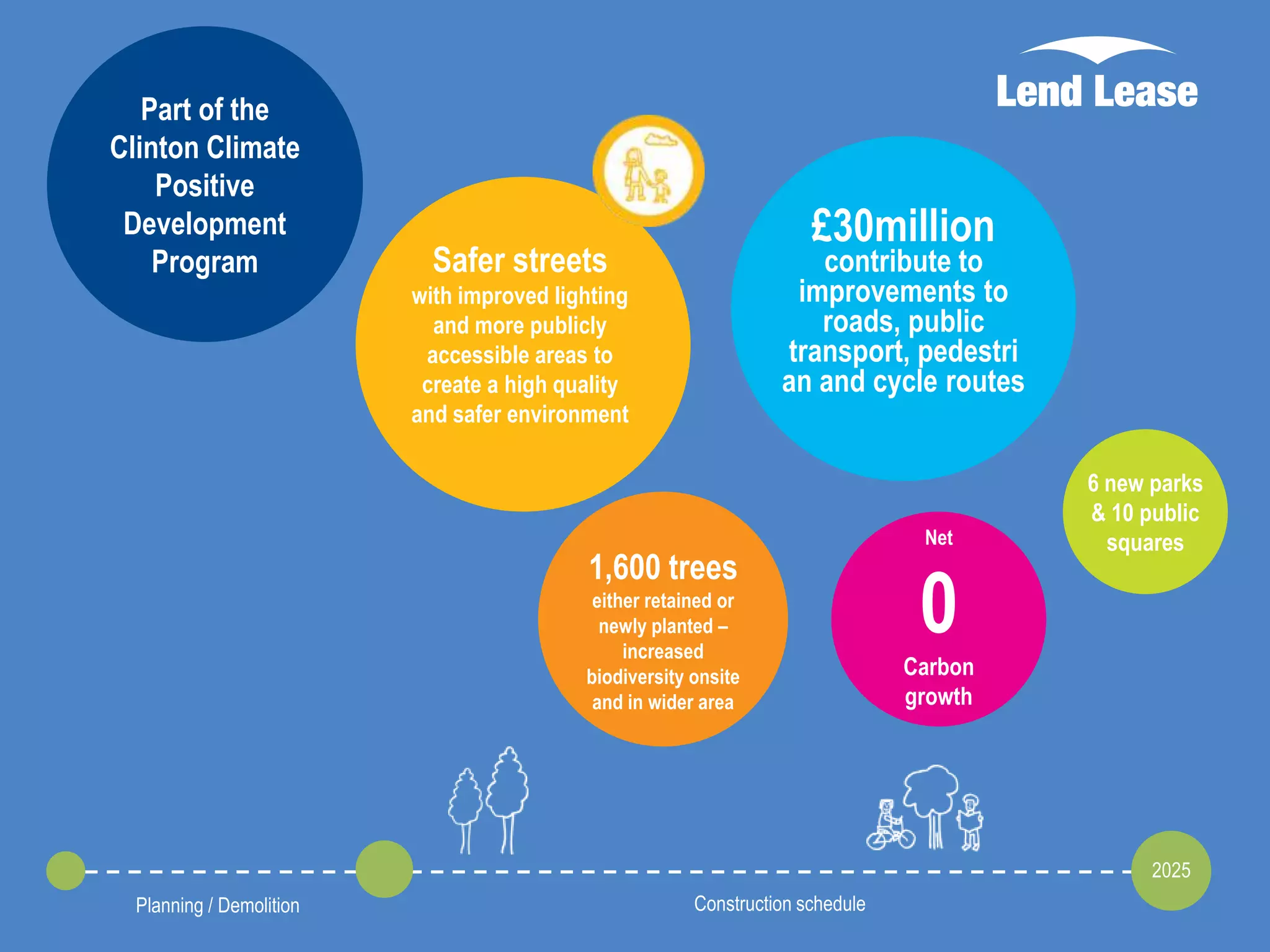

£30million

Safer streets

contribute to
improvements to
roads, public
transport, pedestri
an and cycle routes

with improved lighting
and more publicly
accessible areas to
create a high quality
and safer environment

1,600 trees
either retained or
newly planted –
increased
biodiversity onsite
and in wider area

Net

0

6 new parks
& 10 public
squares

Carbon
growth

2025
Planning / Demolition

Construction schedule

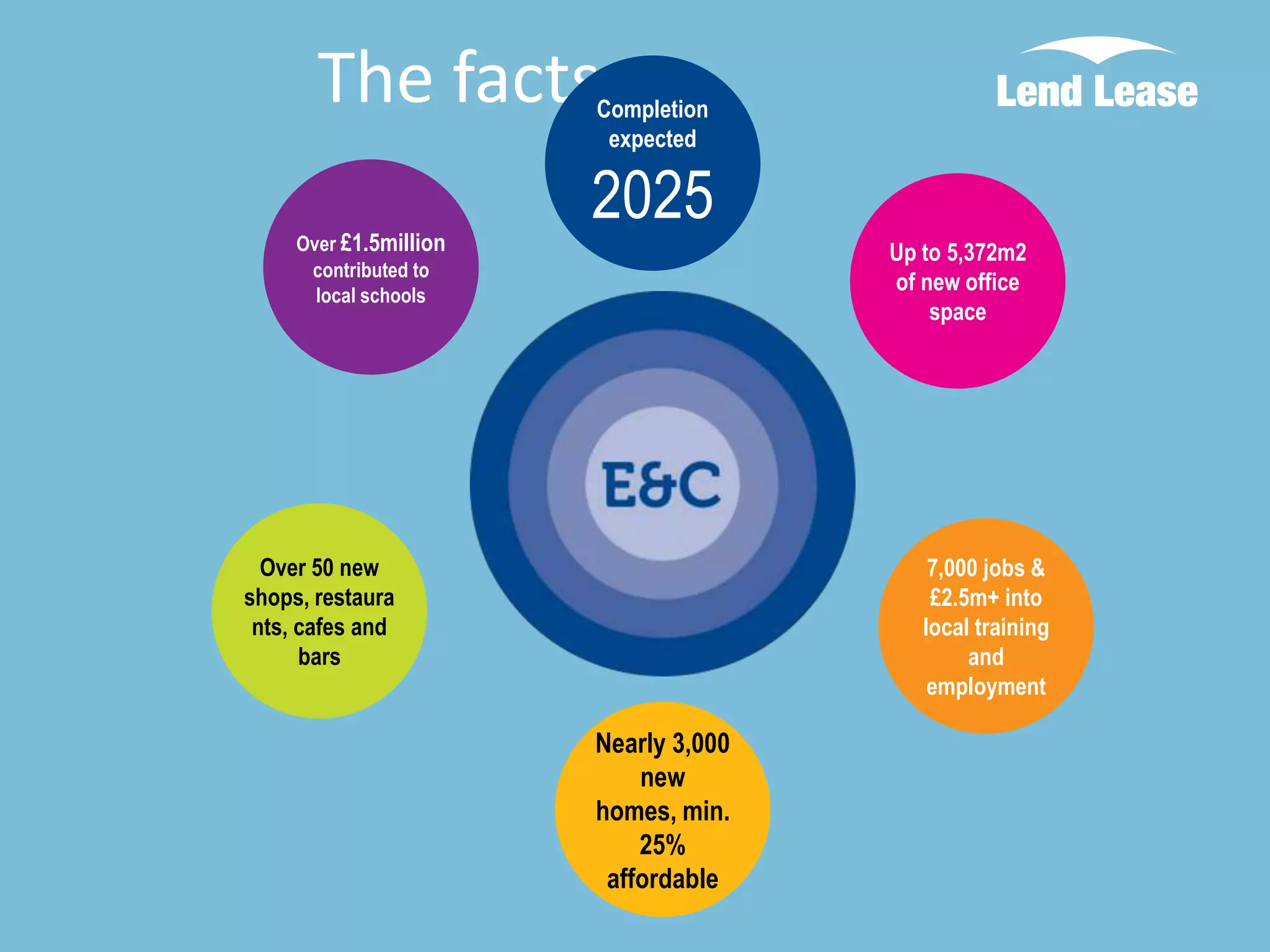

The facts:

Completion
expected

Over £1.5million
contributed to
local schools

2025
Up to 5,372m2
of new office
space

Over 50 new
shops, restaura
nts, cafes and
bars

7,000 jobs &
£2.5m+ into
local training
and
employment

Nearly 3,000
new
homes, min.
25%
affordable
What Makes Elephant and Castle Different –

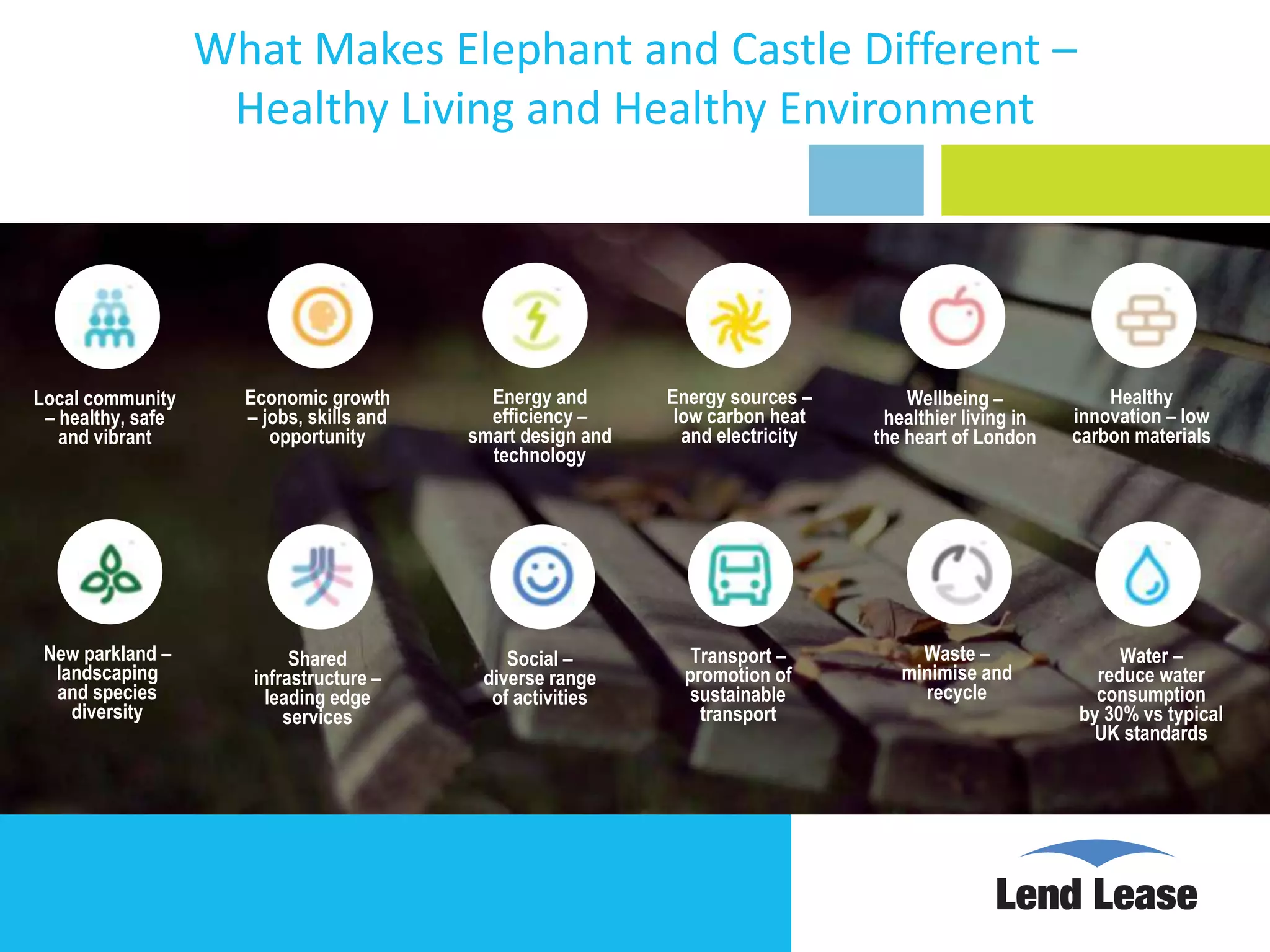

Healthy Living and Healthy Environment

Local community
– healthy, safe
and vibrant

Economic growth
– jobs, skills and
opportunity

Energy and
efficiency –
smart design and
technology

Energy sources –
low carbon heat
and electricity

Wellbeing –
healthier living in
the heart of London

New parkland –
landscaping
and species
diversity

Shared
infrastructure –
leading edge
services

Social –
diverse range
of activities

Transport –
promotion of
sustainable
transport

Waste –
minimise and
recycle

Healthy
innovation – low
carbon materials

Water –
reduce water
consumption
by 30% vs typical
UK standards

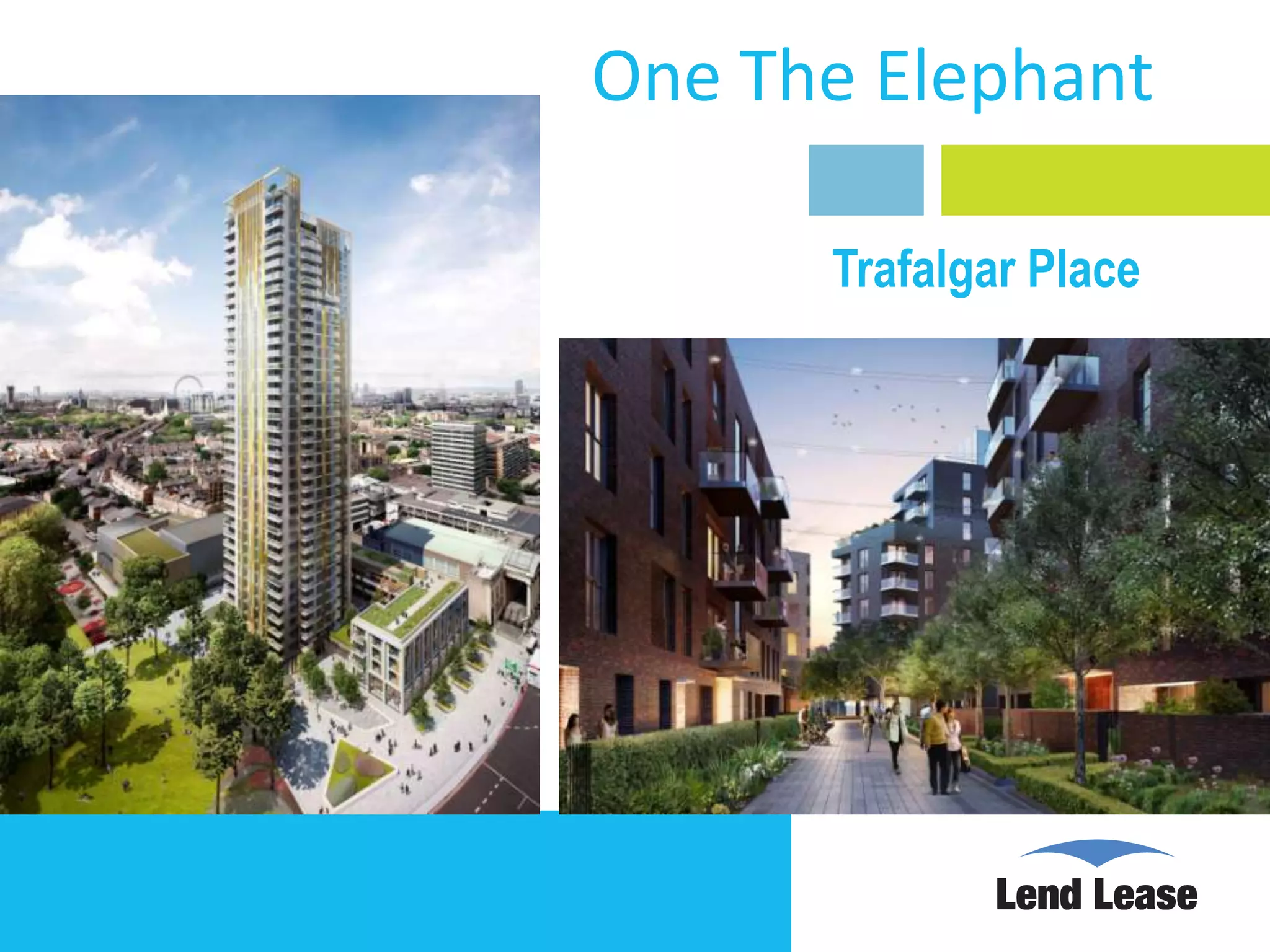

One The Elephant
Trafalgar Place

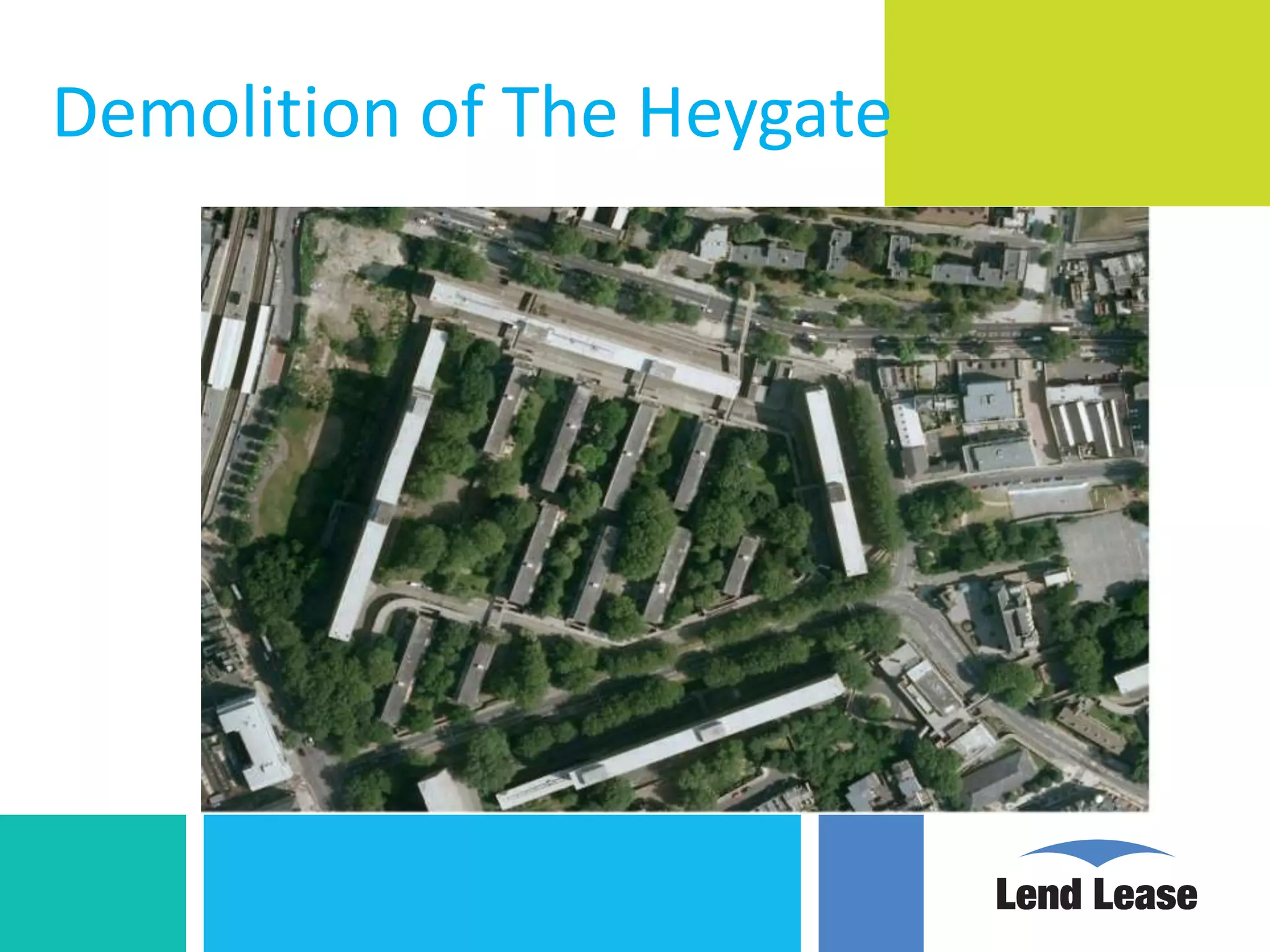

Demolition of The Heygate

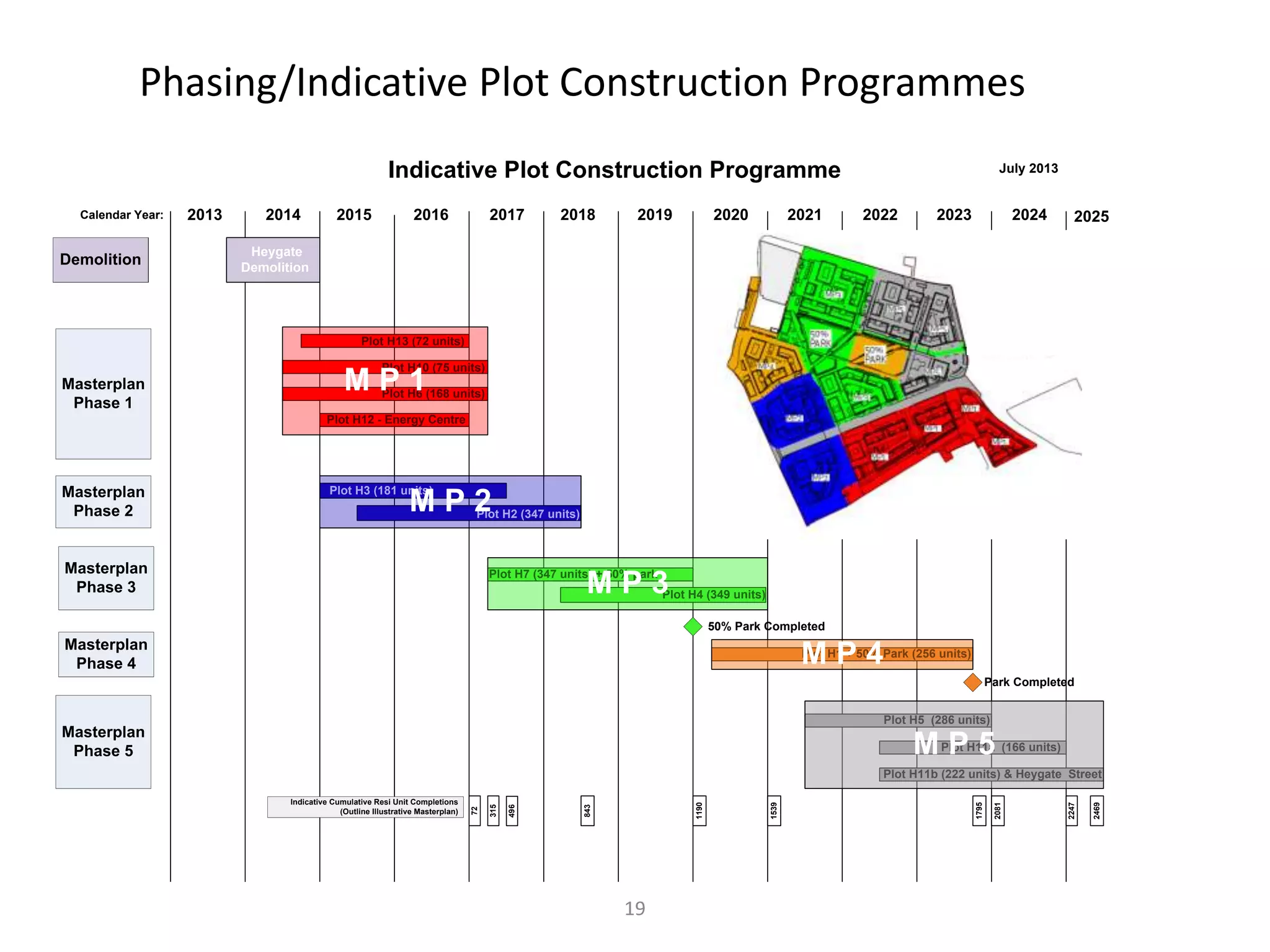

Phasing/Indicative Plot Construction Programmes
Indicative Plot Construction Programme
Calendar Year:

Demolition

2013

2014

2015

2016

2017

2018

2019

2020

2021

July 2013

2022

2023

2024

2025

Heygate
Demolition

Plot H13 (72 units)
Plot H10 (75 units)

Masterplan
Phase 1

MP1

Plot H6 (168 units)

Plot H12 - Energy Centre

Masterplan
Phase 2

Plot H3 (181 units)

MP2

Plot H2 (347 units)

Masterplan
Phase 3

Plot H7 (347 units) + 50% park

MP3

Plot H4 (349 units)
50% Park Completed

Masterplan
Phase 4

MP4

Plot H1 + 50% Park (256 units)
Park Completed
Plot H5 (286 units)

Masterplan
Phase 5

MP5

Plot H11a (166 units)

19

2469

2247

2081

1795

1539

1190

843

496

72

Indicative Cumulative Resi Unit Completions
(Outline Illustrative Masterplan)

315

Plot H11b (222 units) & Heygate Street
Community Feelgood Factor

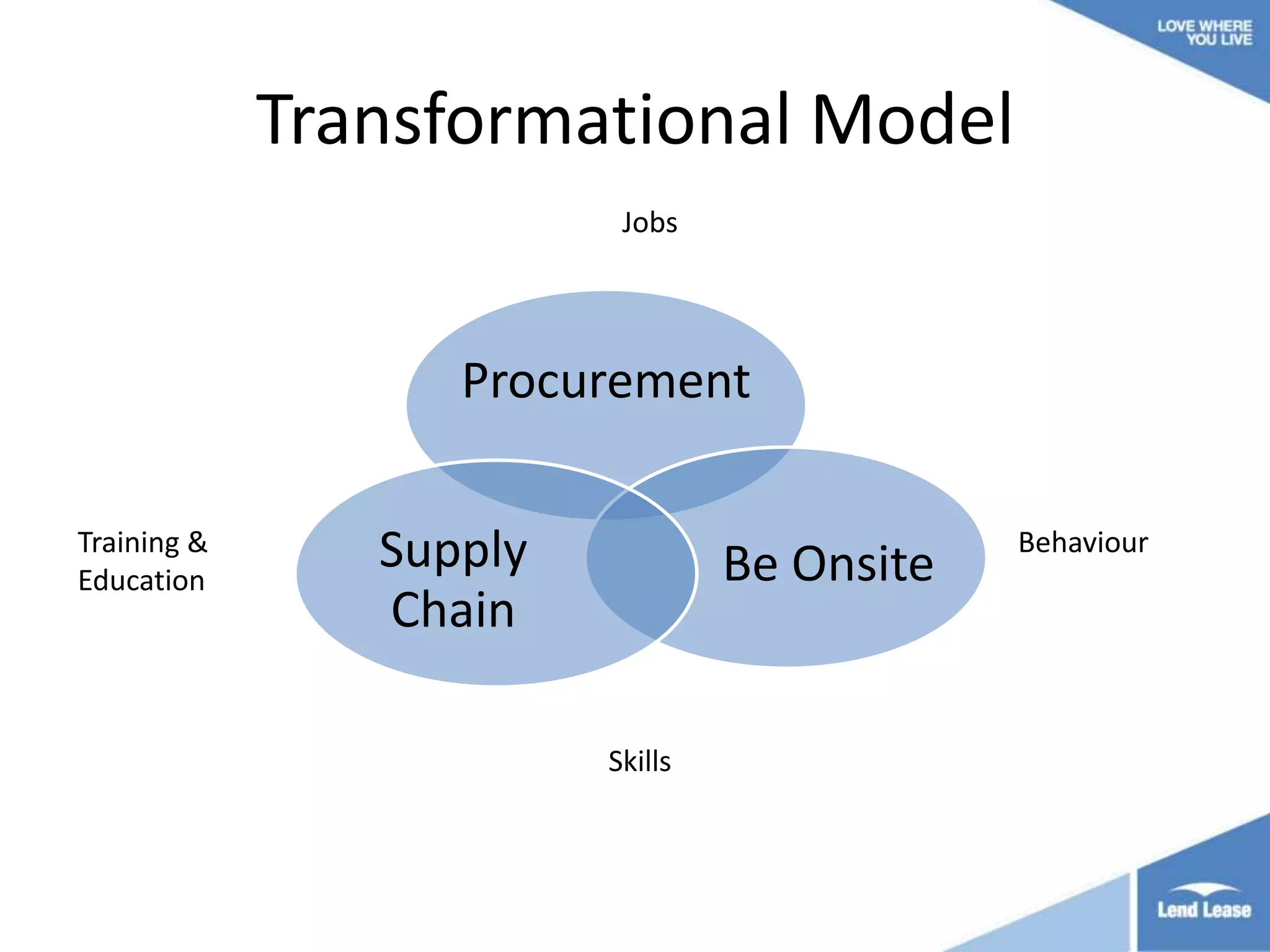

Transformational Model
Jobs

Procurement
Training &
Education

Supply
Chain

Be Onsite

Skills

Behaviour

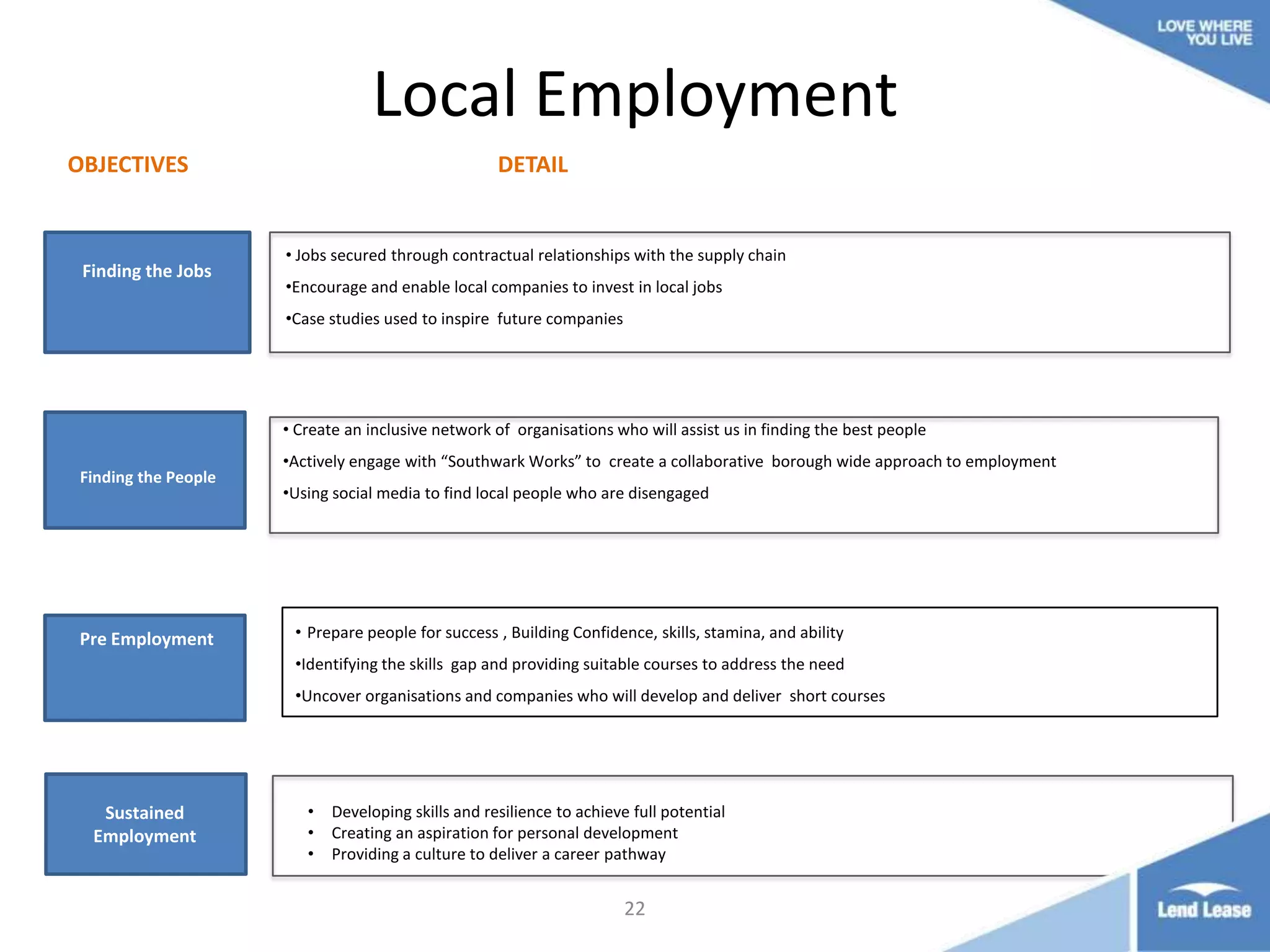

Local Employment
OBJECTIVES

Finding the Jobs

DETAIL

• Jobs secured through contractual relationships with the supply chain
•Encourage and enable local companies to invest in local jobs
•Case studies used to inspire future companies

• Create an inclusive network of organisations who will assist us in finding the best people
Finding the People

Pre Employment

•Actively engage with “Southwark Works” to create a collaborative borough wide approach to employment
•Using social media to find local people who are disengaged

• Prepare people for success , Building Confidence, skills, stamina, and ability
•Identifying the skills gap and providing suitable courses to address the need
•Uncover organisations and companies who will develop and deliver short courses

LONG TERM VISION
Local Procurement
Local Procurement
Equality
Sustained
Employment

•
•
•

Developing skills and resilience to achieve full potential
Creating an aspiration for personal development
Providing a culture to deliver a career pathway

22

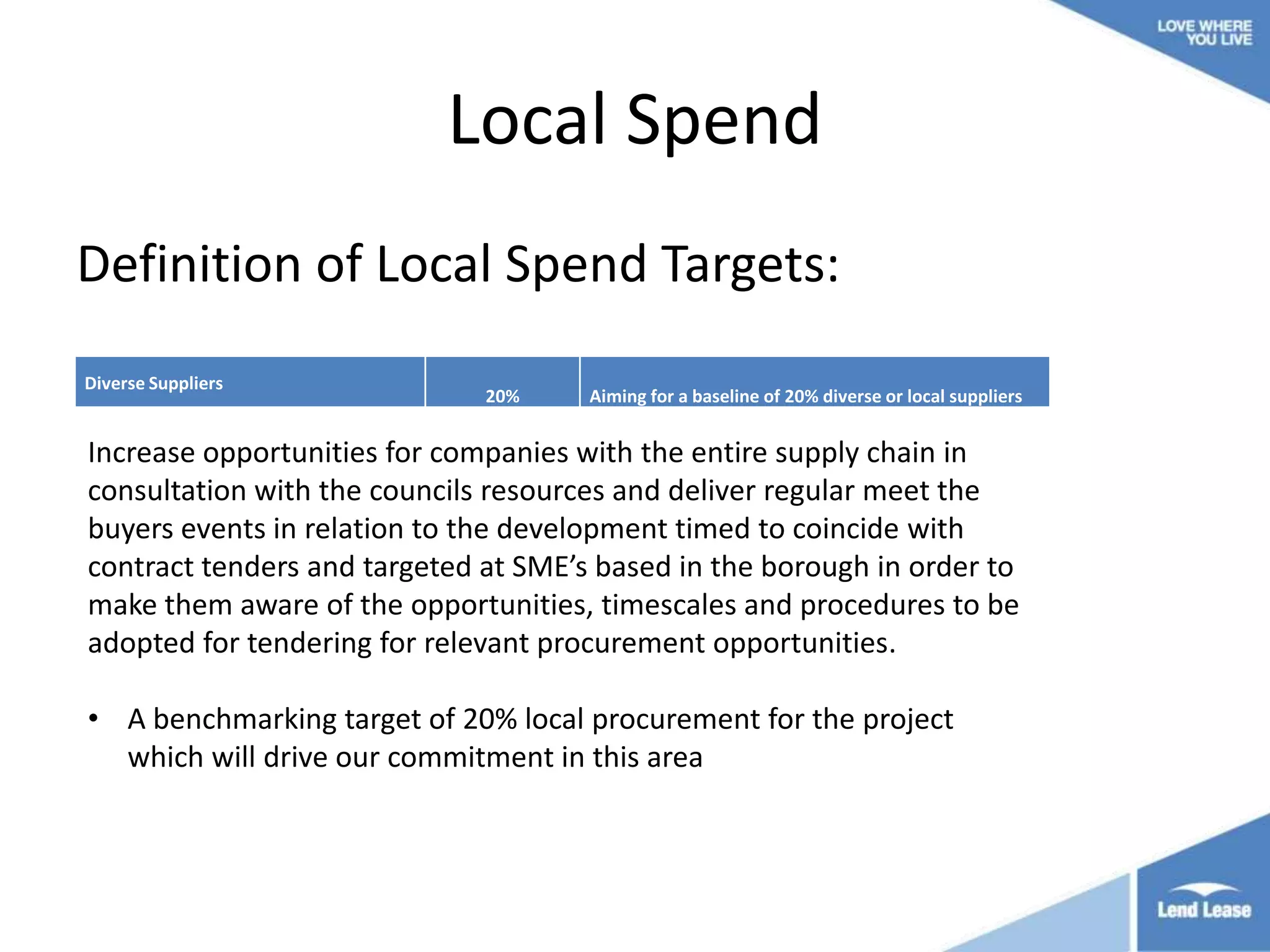

Local Spend
Definition of Local Spend Targets:
Diverse Suppliers

20%

Aiming for a baseline of 20% diverse or local suppliers

Increase opportunities for companies with the entire supply chain in
consultation with the councils resources and deliver regular meet the
buyers events in relation to the development timed to coincide with
contract tenders and targeted at SME’s based in the borough in order to
make them aware of the opportunities, timescales and procedures to be
adopted for tendering for relevant procurement opportunities.
• A benchmarking target of 20% local procurement for the project
which will drive our commitment in this area

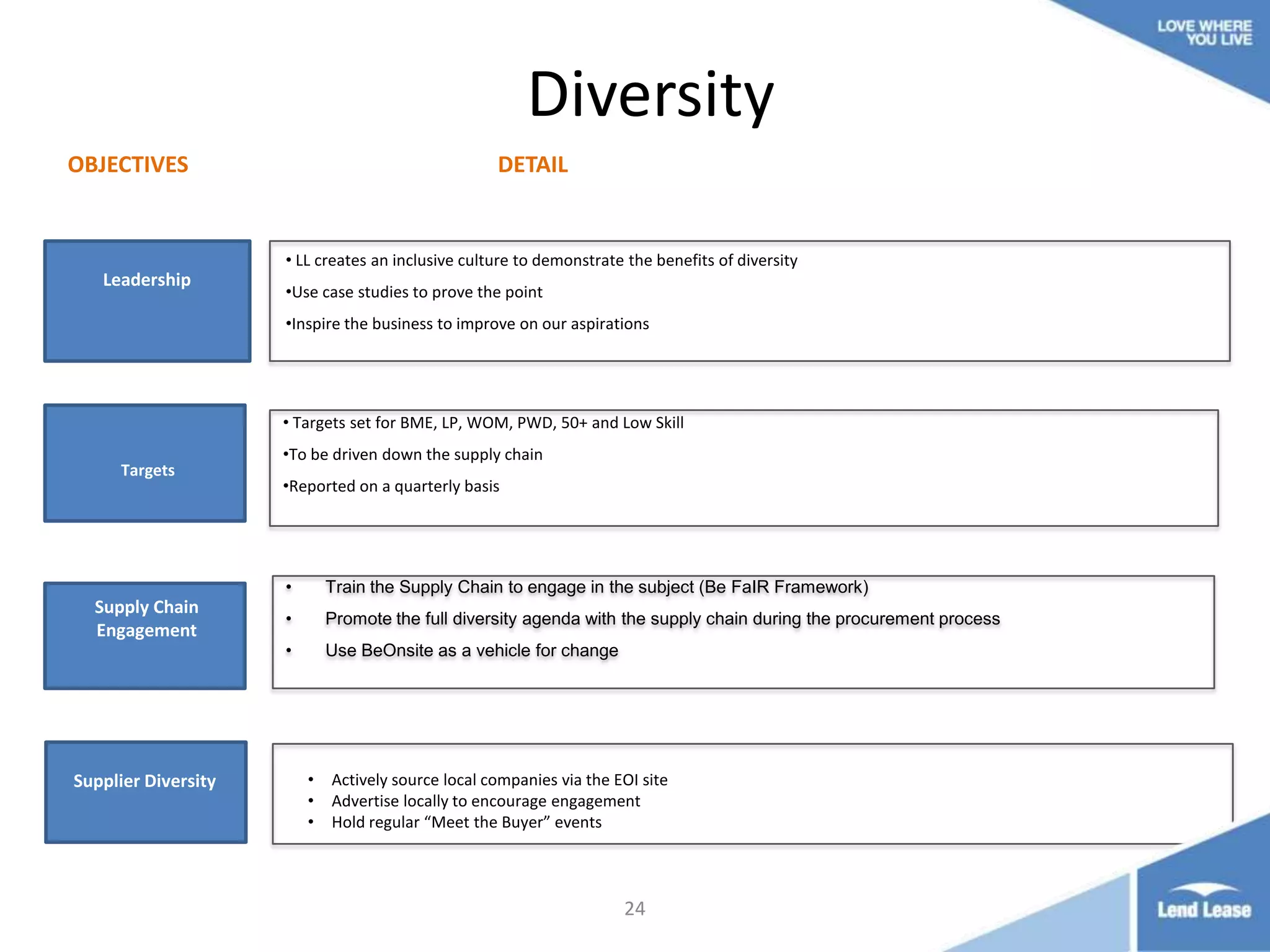

Diversity
OBJECTIVES

DETAIL

• LL creates an inclusive culture to demonstrate the benefits of diversity

Leadership

•Use case studies to prove the point
•Inspire the business to improve on our aspirations

• Targets set for BME, LP, WOM, PWD, 50+ and Low Skill
Targets

•To be driven down the supply chain
•Reported on a quarterly basis

•

Supply Chain
Engagement

Train the Supply Chain to engage in the subject (Be FaIR Framework)

•

Promote the full diversity agenda with the supply chain during the procurement process

•

Use BeOnsite as a vehicle for change

LONG TERM VISION
Local Procurement
Supplier Diversity
Local Procurement
Equality

•
•
•

Actively source local companies via the EOI site
Advertise locally to encourage engagement
Hold regular “Meet the Buyer” events

24

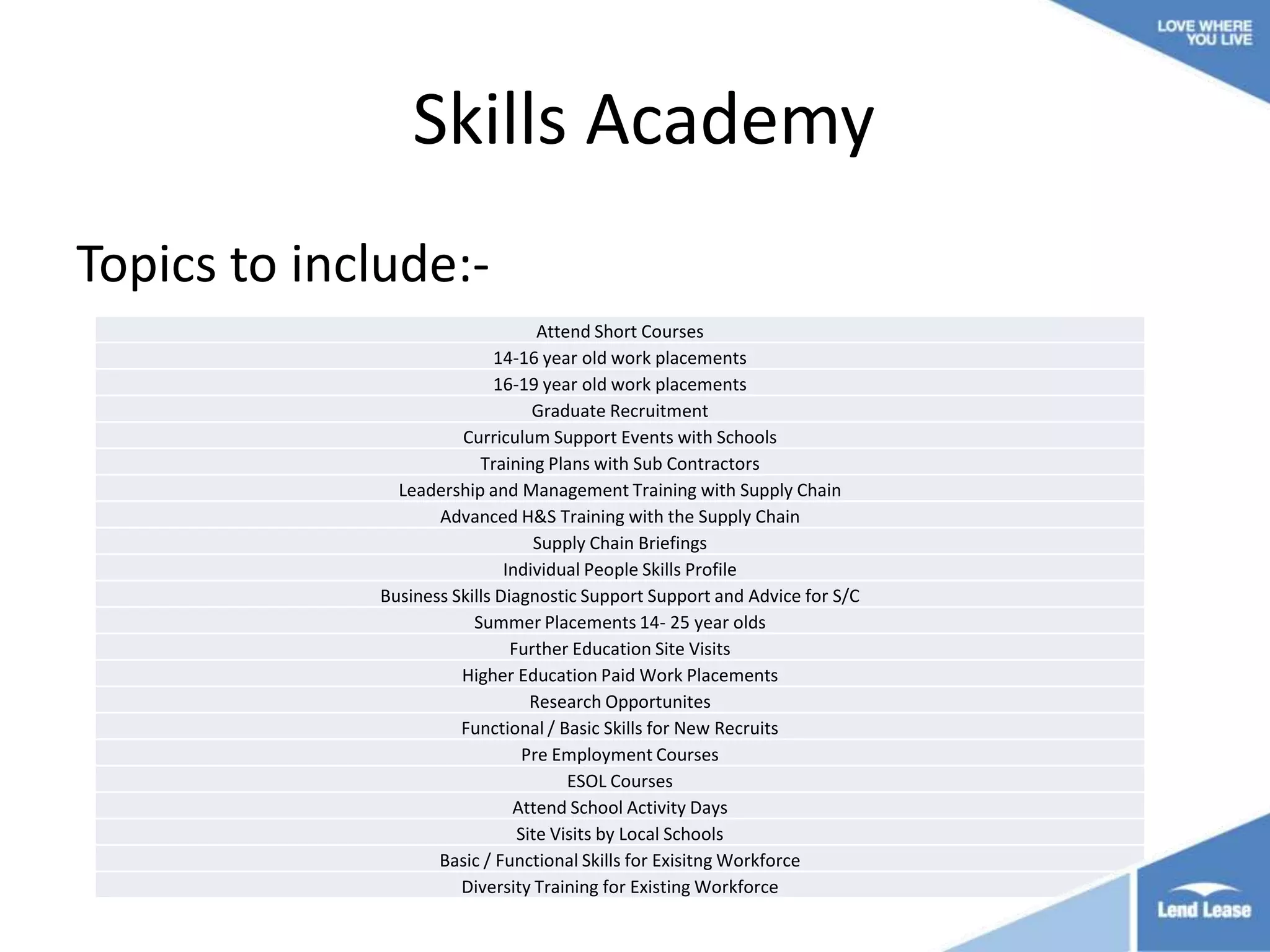

Skills Academy
Topics to include:Attend Short Courses
14-16 year old work placements
16-19 year old work placements
Graduate Recruitment
Curriculum Support Events with Schools
Training Plans with Sub Contractors
Leadership and Management Training with Supply Chain
Advanced H&S Training with the Supply Chain
Supply Chain Briefings
Individual People Skills Profile
Business Skills Diagnostic Support Support and Advice for S/C
Summer Placements 14- 25 year olds
Further Education Site Visits
Higher Education Paid Work Placements
Research Opportunites
Functional / Basic Skills for New Recruits
Pre Employment Courses
ESOL Courses
Attend School Activity Days
Site Visits by Local Schools
Basic / Functional Skills for Exisitng Workforce
Diversity Training for Existing Workforce

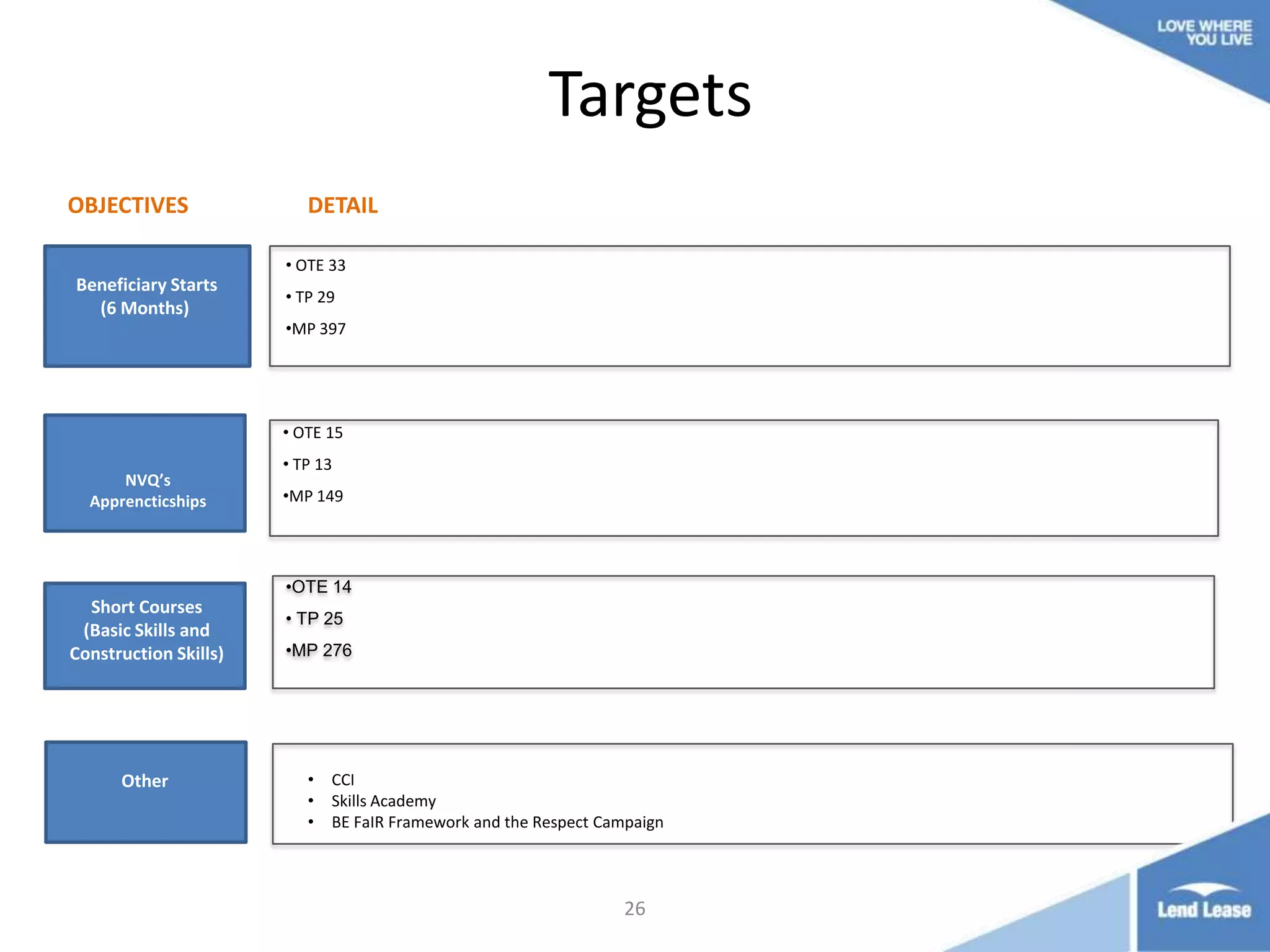

Targets
OBJECTIVES

DETAIL
• OTE 33

Beneficiary Starts
(6 Months)

• TP 29
•MP 397

• OTE 15
NVQ’s
Apprencticships

• TP 13
•MP 149

•OTE 14

Short Courses
(Basic Skills and
Construction Skills)

• TP 25
•MP 276

LONG TERM VISION
Local Procurement
Local Other
Equality
Procurement

•
•
•

CCI
Skills Academy
BE FaIR Framework and the Respect Campaign

26
We want to hear from you if?
• You have a presence within Southwark
• You have a unique product which delivers
an innovation against current practice
• You have the ability to co invest in the
local community
Established to help SMEs build their
businesses
Embracing best practice
Leveraging the good work you do to win
more business
Headline
Sponsor:

28

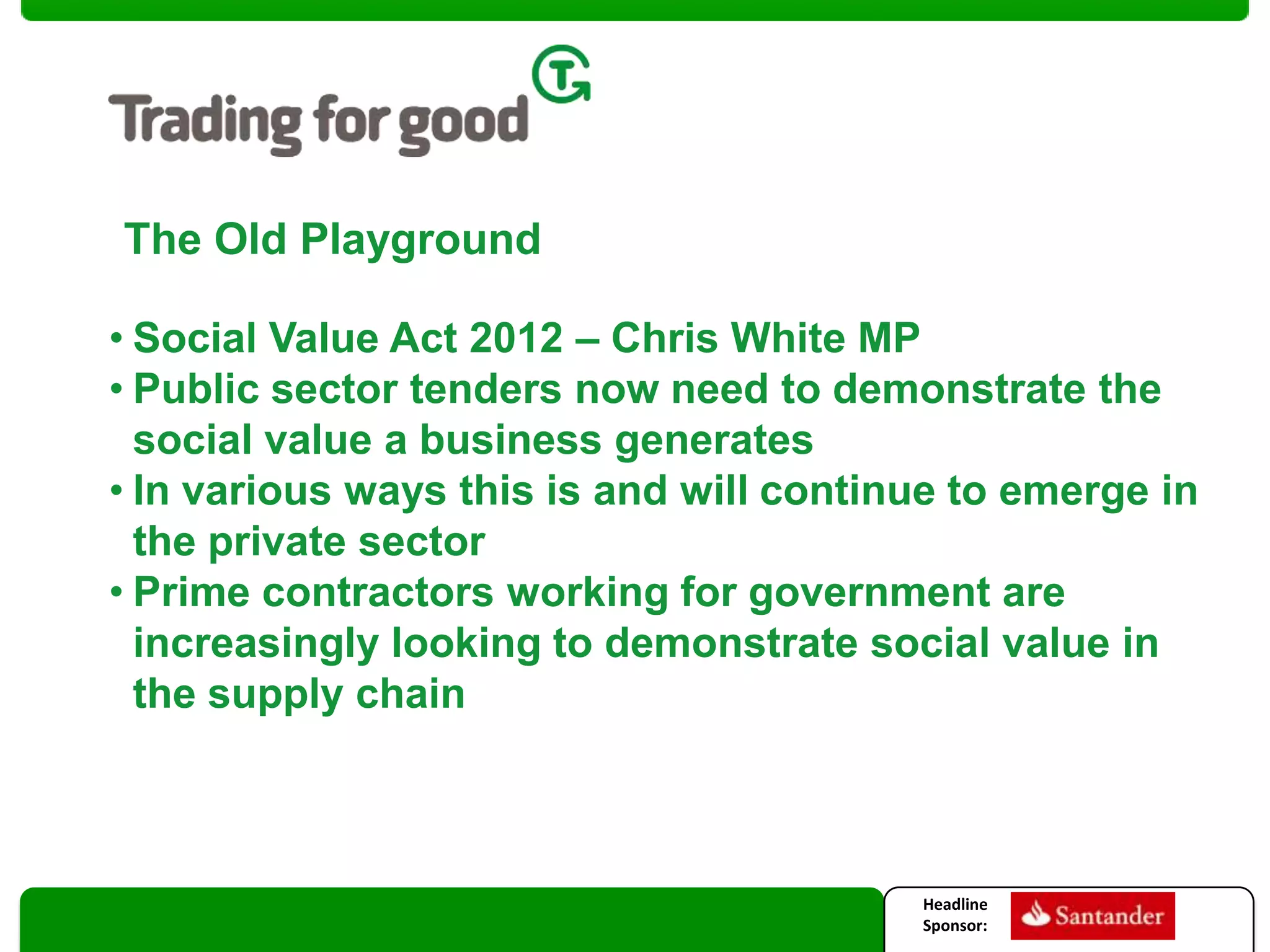

The Old Playground
• Social Value Act 2012 – Chris White MP
• Public sector tenders now need to demonstrate the
social value a business generates
• In various ways this is and will continue to emerge in
the private sector
• Prime contractors working for government are
increasingly looking to demonstrate social value in
the supply chain

Headline
Sponsor:

2
Social Value – What is it????
Anything from simple sponsorship of a local
school fete…
How you look after your staff – health and wellbeing
How you work with young people, apprentices
for example
How you work with your environment –
recycling to how you procure your goods and
services
Volunteering, charitable giving
Headline
Sponsor:

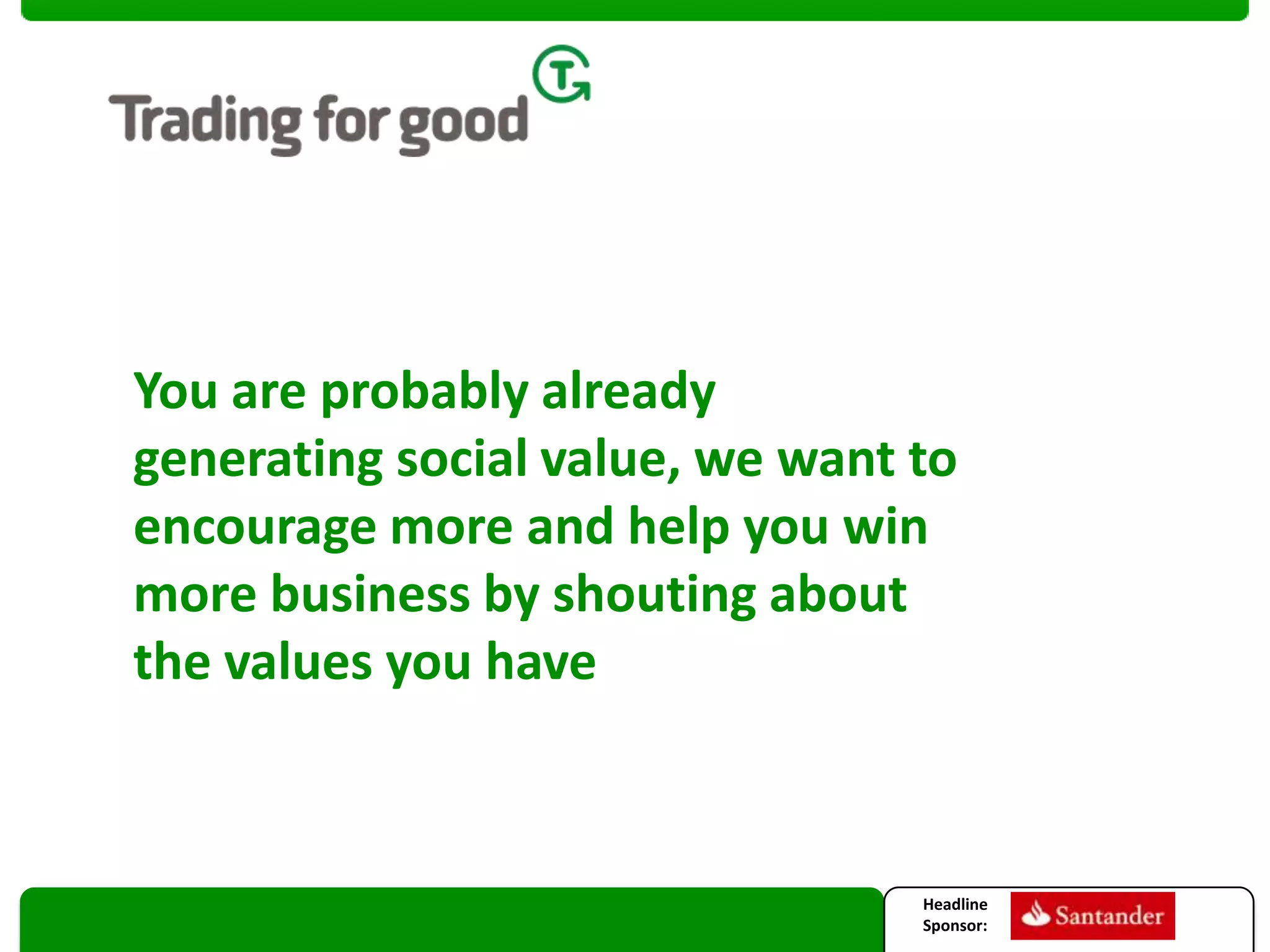

You are probably already
generating social value, we want to
encourage more and help you win
more business by shouting about
the values you have

Headline
Sponsor:

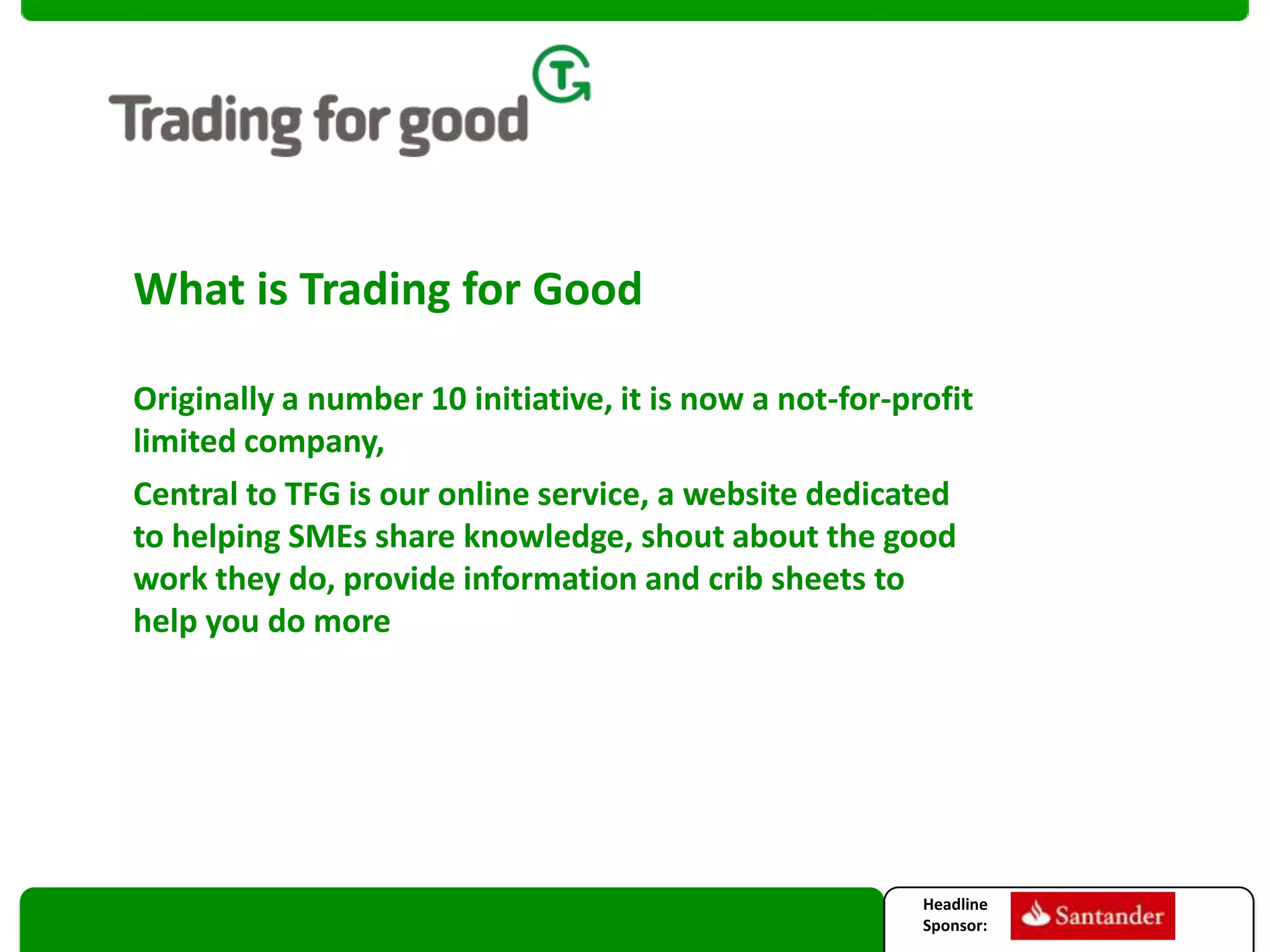

What is Trading for Good
Originally a number 10 initiative, it is now a not-for-profit
limited company,
Central to TFG is our online service, a website dedicated
to helping SMEs share knowledge, shout about the good
work they do, provide information and crib sheets to
help you do more

Headline
Sponsor:

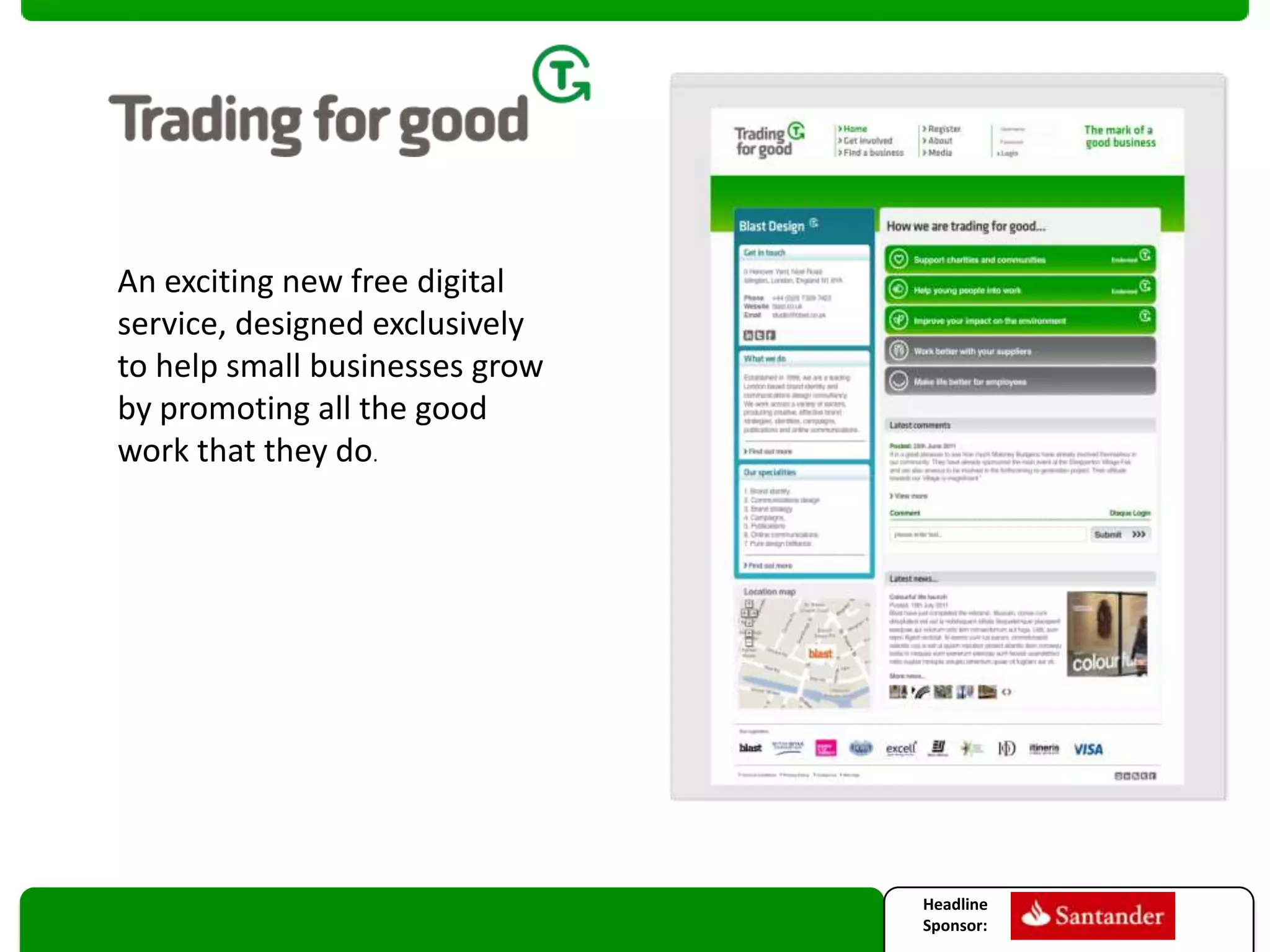

An exciting new free digital
service, designed exclusively
to help small businesses grow
by promoting all the good
work that they do.

Headline
Sponsor:
Headline
Sponsor:

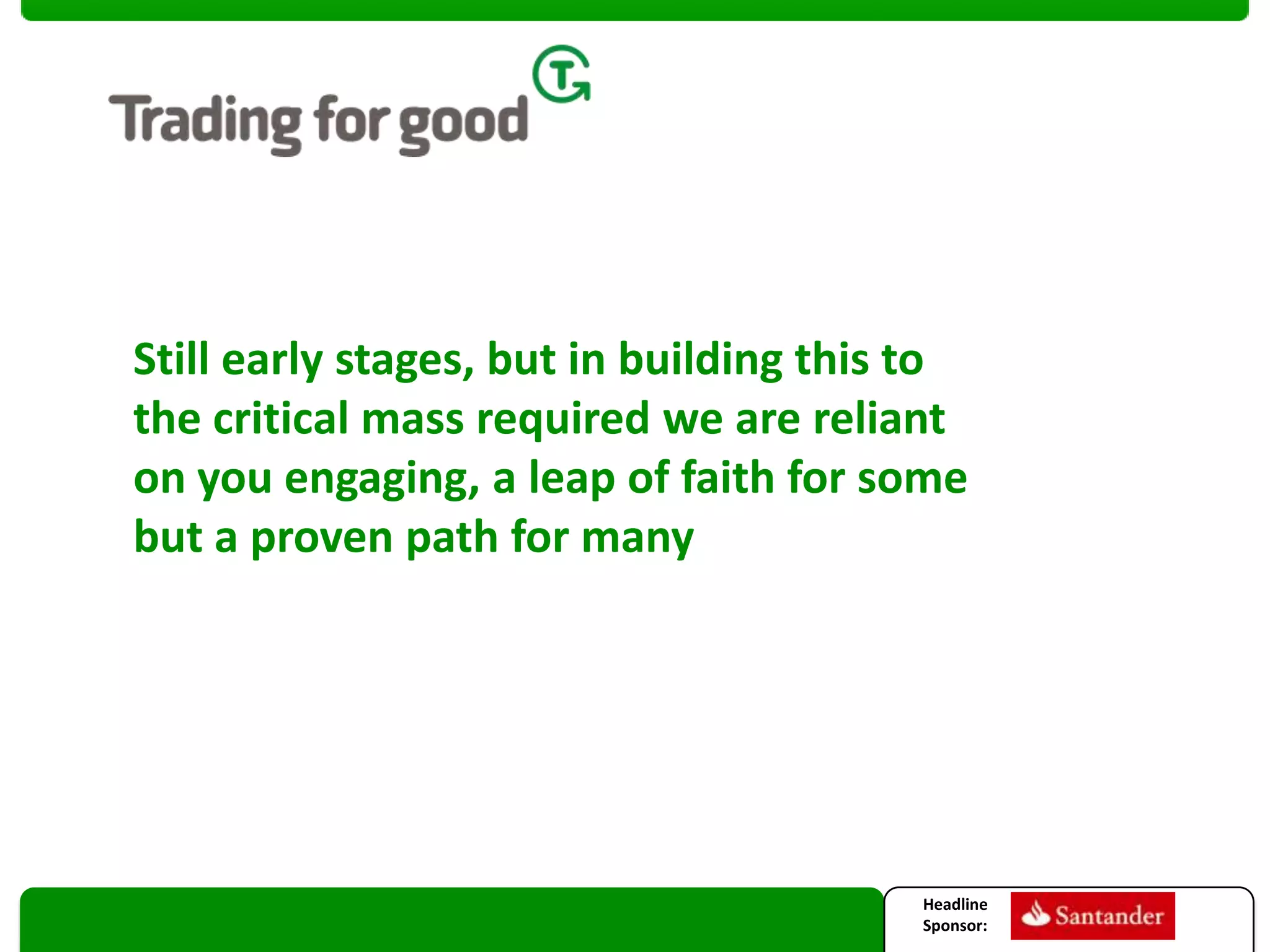

Still early stages, but in building this to
the critical mass required we are reliant
on you engaging, a leap of faith for some
but a proven path for many

Headline
Sponsor:

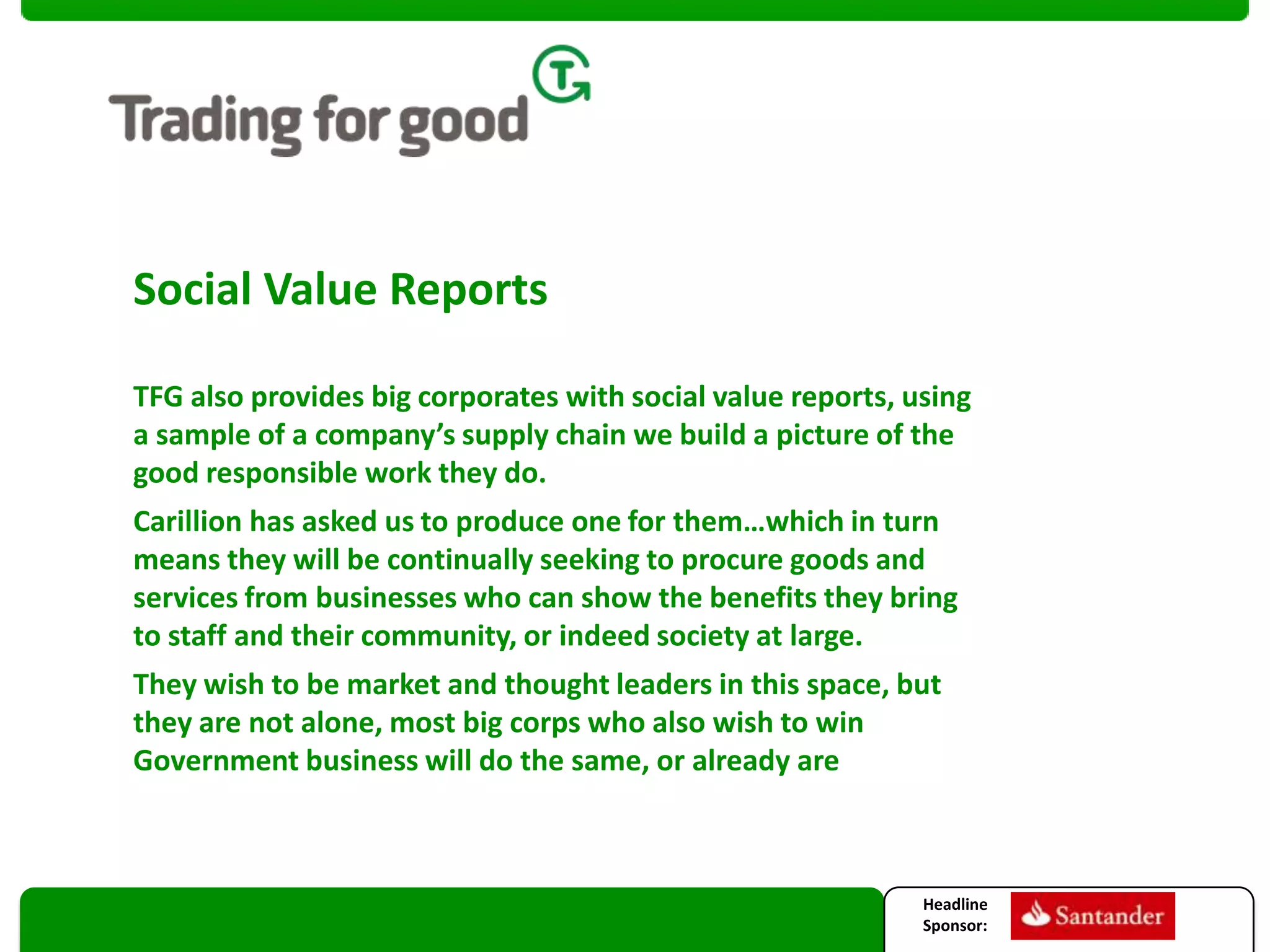

Social Value Reports
TFG also provides big corporates with social value reports, using
a sample of a company’s supply chain we build a picture of the
good responsible work they do.
Carillion has asked us to produce one for them…which in turn
means they will be continually seeking to procure goods and
services from businesses who can show the benefits they bring
to staff and their community, or indeed society at large.
They wish to be market and thought leaders in this space, but
they are not alone, most big corps who also wish to win
Government business will do the same, or already are

Headline
Sponsor:
Ambitions:
• To create the UK’s most recognisable brand for
responsible business
• To connect the brand of T4G to good business
directories
• To become the trusted hub of information for SME’s on
responsible business practice
• Generate data on key issues – reports to BIS
• Enable the public to easily see what an SME is doing
locally
• Inspire peer to peer examples
• Prompt consumer behaviour to purchase locally /
responsibly
Headline
Sponsor:

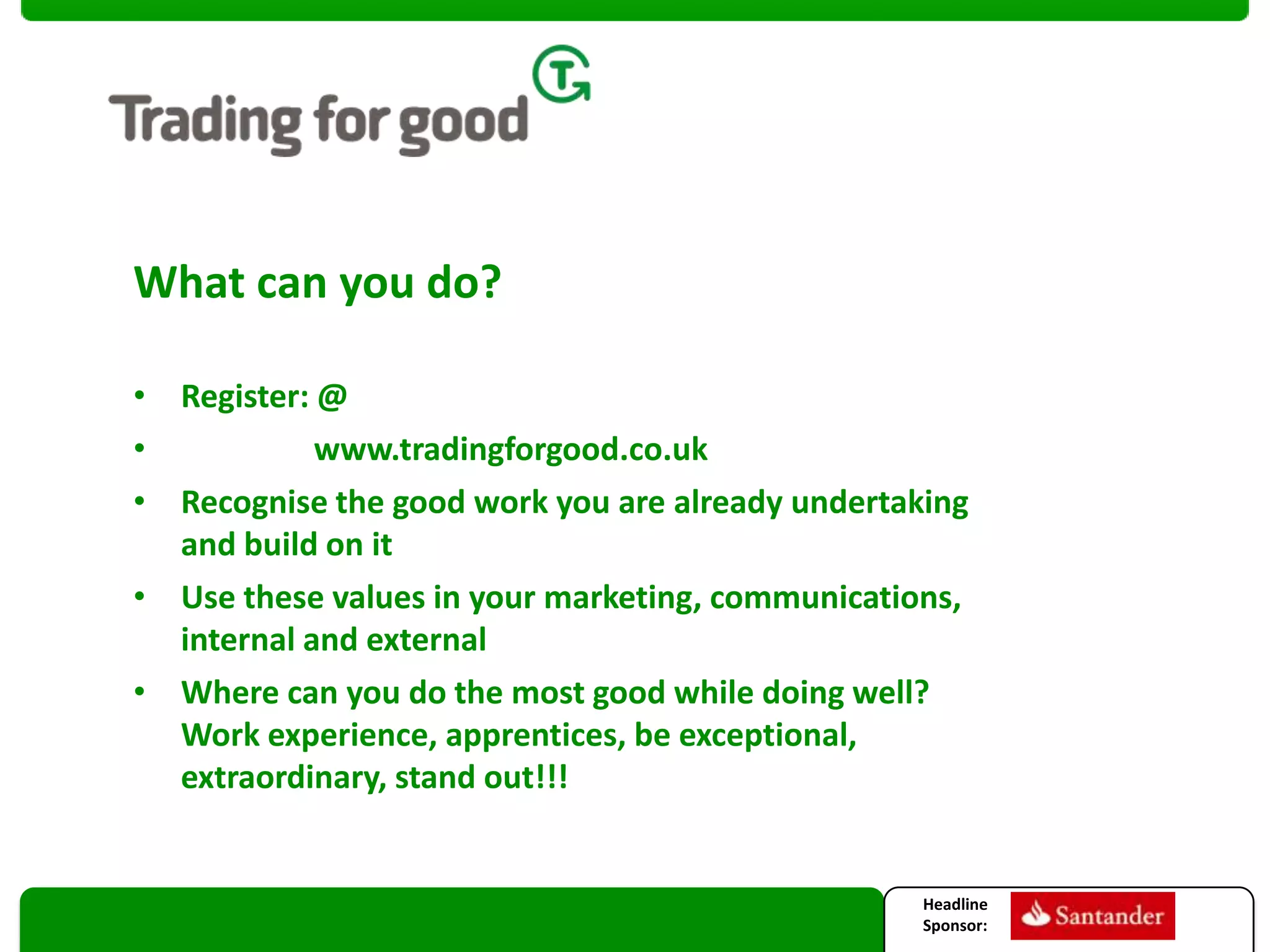

What can you do?
• Register: @
•
www.tradingforgood.co.uk
• Recognise the good work you are already undertaking
and build on it
• Use these values in your marketing, communications,
internal and external
• Where can you do the most good while doing well?
Work experience, apprentices, be exceptional,
extraordinary, stand out!!!

Headline
Sponsor:
Q&A
And thanks
Headline
Sponsor:

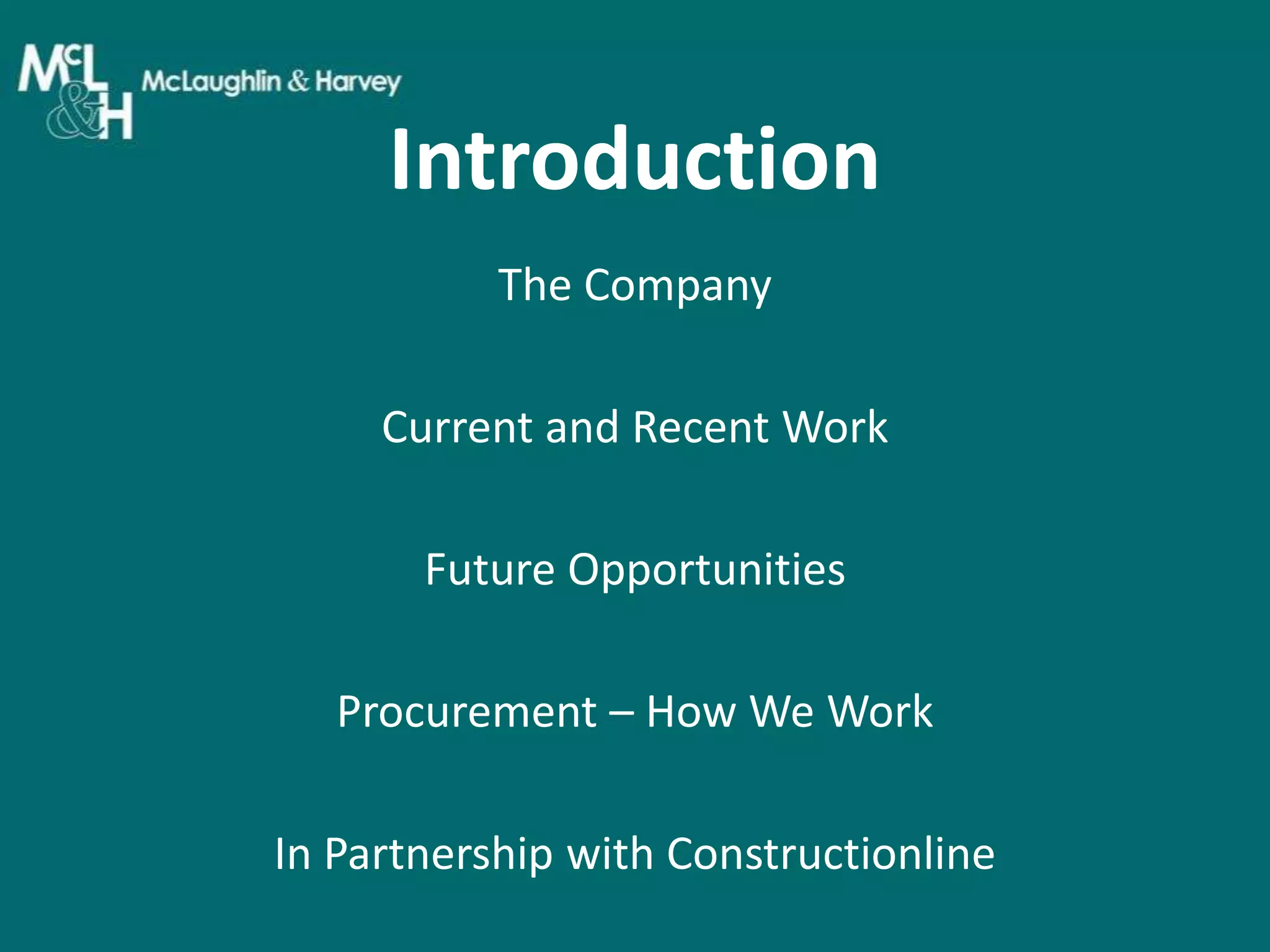

Introduction
The Company
Current and Recent Work

Future Opportunities
Procurement – How We Work
In Partnership with Constructionline

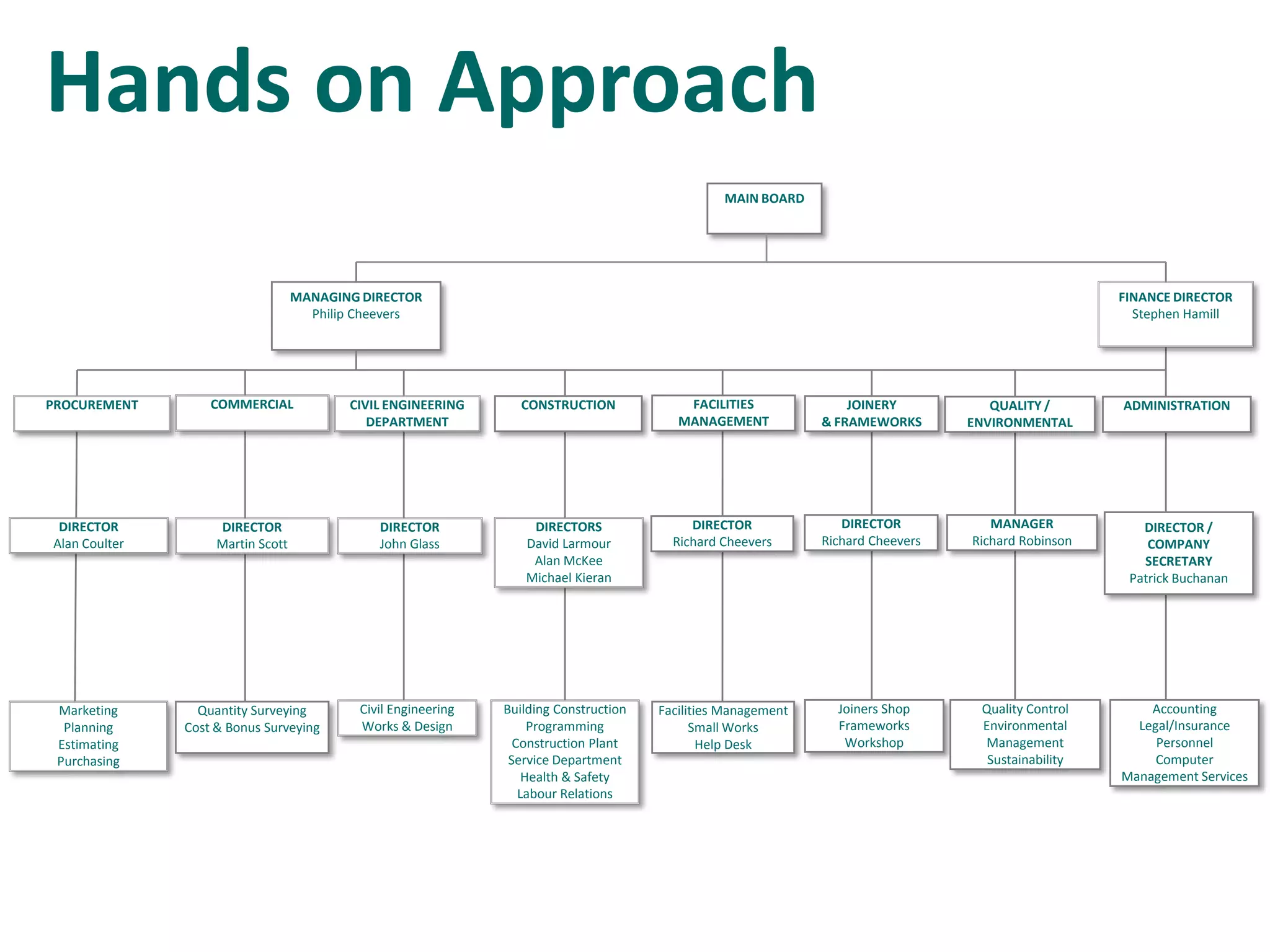

Hands on Approach
MAIN BOARD

MANAGING DIRECTOR
Philip Cheevers

FINANCE DIRECTOR
Stephen Hamill

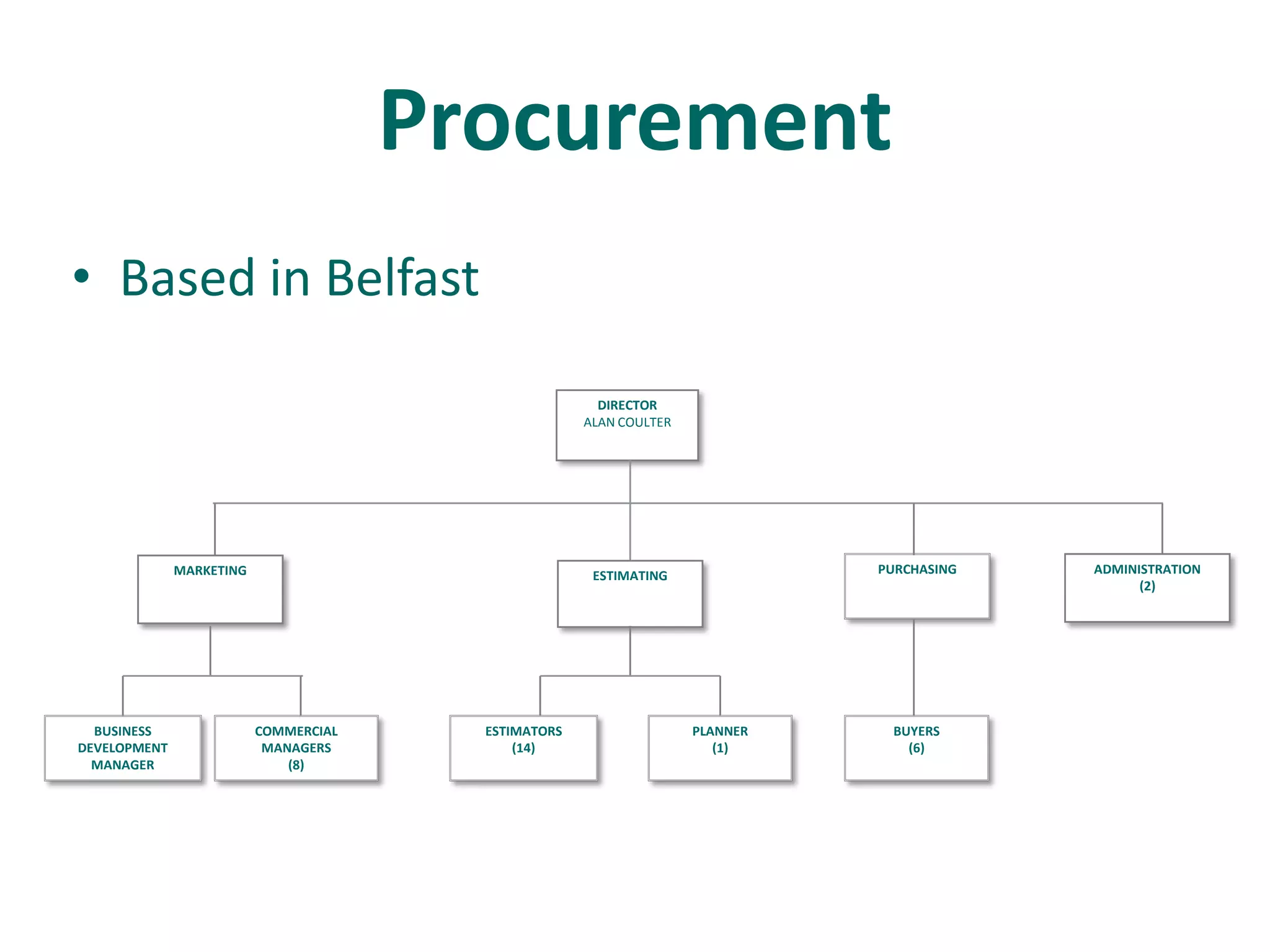

PROCUREMENT

COMMERCIAL

CIVIL ENGINEERING
DEPARTMENT

CONSTRUCTION

FACILITIES
MANAGEMENT

JOINERY
& FRAMEWORKS

QUALITY /
ENVIRONMENTAL

ADMINISTRATION

DIRECTOR
Alan Coulter

DIRECTOR
Martin Scott

DIRECTOR
John Glass

DIRECTORS
David Larmour
Alan McKee
Michael Kieran

DIRECTOR
Richard Cheevers

DIRECTOR
Richard Cheevers

MANAGER
Richard Robinson

DIRECTOR /
COMPANY
SECRETARY
Patrick Buchanan

Marketing
Planning
Estimating
Purchasing

Quantity Surveying
Cost & Bonus Surveying

Civil Engineering
Works & Design

Building Construction
Programming
Construction Plant
Service Department
Health & Safety
Labour Relations

Facilities Management
Small Works
Help Desk

Joiners Shop
Frameworks
Workshop

Quality Control
Environmental
Management
Sustainability

Accounting
Legal/Insurance
Personnel
Computer
Management Services
Capabilities

Building Construction

Civil Engineering

Facilities Management &
Small Works

Fit-Out

Offshore & Onshore
Sustainable Energy

Aluminium Windows &
Curtain Walling
G1 Building, Glasgow
£26 million
Loch Ryan Terminal, Cairnryan
£57 million
Victoria Terminal, Belfast
£37 million
Downe Hospital, Downpatrick
£55 million
Royal Victoria Hospital, Belfast
£120 million
Sainsbury’s, Salford
£7 million
Sainsbury’s, Wigan
£7 million
Sainsbury’s, Edinburgh
£10 million
Tesco, Newtownabbey
£15 million
Tesco, Newtownards
£10 million
Torry Quay, Aberdeen
£13 million
M&S – Durham Arnison
Project Fortis - Glasgow
St Columba’s High School

Slide 19

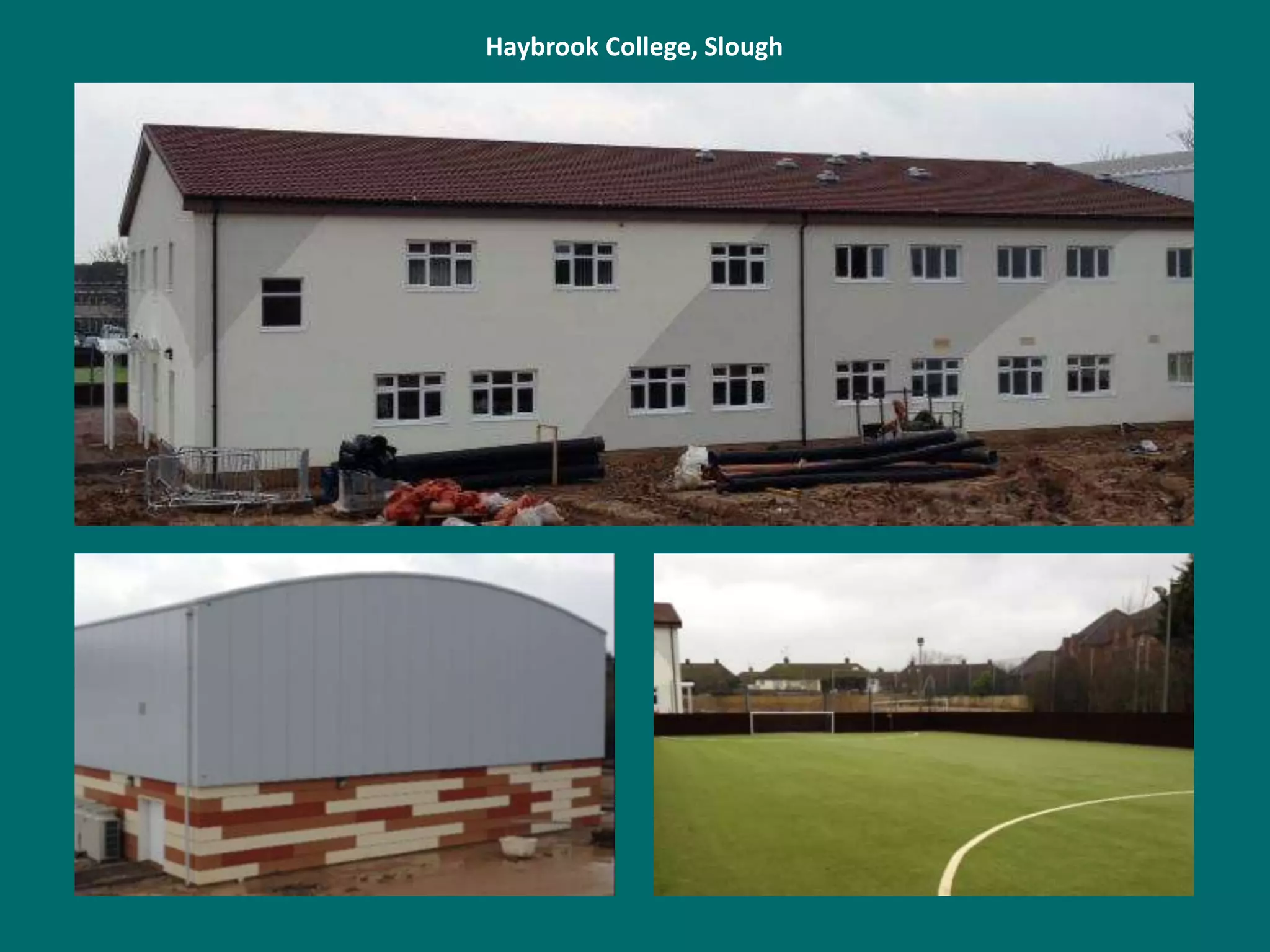

Haybrook College, Slough
Kings College Hospital
Peacocks Walk, Woking

Principal Contractors Frameworks

Commercial Way, Woking

Little Heath School, Tilehurst

Dunstable College

Ryvers School, Slough

M&S, Bristol & Harrogate

House of Commons

M&S, Berkhamstead

Russell Lower School, Bedfordshire

Primark, Camberley
Selfridges, Oxford Street
Hillbrook Primary School, Wandsworth
Future Opportunities
•
•
•
•
•
•
•

Schools
Hospitals
Retail
Fit-out
Heritage
Data centres
Marine &
Harbours
• Energy
Health & Safety Standards
•

OHSAS 18001

•

Health & Safety Training for all Staff

•

Contract Specific Site Inductions

•

Careful Selection & Monitoring of
Subcontractors

•

Risk Assessments & Method Statements

•

Health & Safety Inspections & Audits

•

In-house Health & Safety Team

•

KPI’s
Health & Safety Cultural Journey
Health & Safety Awards
• RoSPA Occupational Safety Awards:
• 2013 Gold
• 2012 Gold
• 2011 Gold
• 2010 Silver
• British Safety Council International Safety Awards:
• 2013 Merit
• 2012 Merit
• 2011 Merit
• 2010 Pass
• National Irish Safety Organisation / Northern Ireland
Safety Group Occupational Safety Prestigious Award 2011
Procurement
• Based in Belfast
DIRECTOR
ALAN COULTER

MARKETING

BUSINESS
DEVELOPMENT
MANAGER

PURCHASING

ESTIMATING

COMMERCIAL
MANAGERS
(8)

ESTIMATORS
(14)

PLANNER
(1)

BUYERS
(6)

ADMINISTRATION
(2)
Pre-qualification
• Avoid Duplication & Administration Costs
• Constructionline – PAS91
• Safety Standards in Procurement
Subcontractors & Supply Chain
•
•
•
•

Estimating
Buying
E-zines
Constructionline
Opportunities Board
• Strong robust business
• Diverse range of projects

• Commitment to price
• Nationwide coverage
• Constructive Dialogue
• Support local sub contractors
• ‘Right place, right time’
• Clear Subcontracts & Orders
• Prompt Payment
• Long Term Relationships
Kilmarnock College
Why Constructionline?
•
•
•
•

Nationwide Database
Regional Events
In touch with Government Construction Strategy
Helping drive down paperwork in pre qualification
• Dedicated point of contact
• Support staff
SSIP and PAS 91
Benefits for Buyers and Suppliers
Paul Reeve CFIOSH CEnv FIEMA
Director of Business Services, ECA
Aims of this presentation
To outline:

- what SSIP and PAS 91 are
- how they help buyers and suppliers

- what we need from them in future...
Quick background to SSIP
SSIP was launched in 2009 against backdrop of:
•

Mushrooming HS assessment schemes /company
PQQs, claiming to provide ‘the best answer to PQQ’
etc.
•

Broad realisation that the safety pre-qualification
landscape imposes unnecessary costs on suppliers

• Several SSIP member schemes agreed to use
common (core) pre-qualification criteria, based on the
HSE’s CDM 2007 ACoP.
Core criteria are essential…
• The MCG (now UKCG) drafted pre-qualification
‘core criteria’ for construction in the early 2000s
• ECA and HVCA (now B&ES) launched HSE-backed
core criteria in 2006 – based on common good
practice and basic legal requirements. Similar core
criteria then appeared in the CDM 2007 ACoP

• Enter SSIP - HSE worked with SSIP to ensure SSIP
assessment criteria agreed with the core criteria
• In 2010 PAS 91 (construction PQQs) adopted the
core criteria…
SSIP scheme recognition
Cross recognition
• If a supplier has been successfully assessed by one
SSIP member, then that assessment should be
suitably (ideally fully) recognised by the others*
One way recognition
• E.g. schemes recognise OHSAS 18001 from a UKASaccredited SSIP member certifier – this part works
particularly well…
*though there may be an administrative fee
What is cross-recognised?
• The suppliers’ basic HS capability only

• CDM core criteria ‘Stage 1’ only
• Stage 2 (project-specific questions) is the buyer’s
responsibility
These questions depend on circumstances, so they
cannot be standardised for desktop assessment.
Savings due to SSIP

Three key questions are:
1. What type of savings does it deliver?
2. How big are those savings? and
3. Who benefits from them?
Benefits of SSIP: to suppliers
• Fewer duplicate/different questionnaires - saving time
and money (feedback from schemes and TAs shows
this is happening)
• Suppliers are most concerned about the time it takes to
engage with PQQs
• ‘Deemed to satisfy’ (cross-recognition) delivered at
least £10 million in savings to suppliers in 2013
SSIP members include…
Deemed to satisfy?
Of the myriad SSIP schemes:

85% of the known savings came from DTS
provided by just four schemes…
…and nearly 75% from just two.
More to this than DTS…
• DTS is one indicator of savings, but it can be
misleading
• DTS is an indicator of the problem…
• Savings to both buyers and suppliers also come when
a buyer:
• simply asks for ‘SSIP member’ assessment
• can easily check a supplier’s assessment
Benefits of SSIP: to buyers
• Confidence a supplier has been assessed to the
core criteria
• Less time and effort required to assess a
contractor’s/consultant’s basic responses
• More choice of suppliers (when seen as an
advantage!)
The SSIP Portal
•

Central verification database – lists 10,000s of
contractors assessed by SSIP members
•

Verifies that a contractor holds current SSIP
member assessment/certification
•

•

Reduces PQQ time, effort and duplication

£100 per annum for buyers to search the portal
Free to bona fide buyers by Q2 2014?
www.ssipportal.org.uk
Safety Schemes in Procurement…
… is not the perfect supply chain solution to HS prequalification problems*
But it is (demonstrably) a solution – for basic HS
PQQs, still the ‘best game in town’
However, the pressure is building up for SSIP to
deliver much more…
Quick background to PAS 91
•

Effectively the draft Standard for basic
construction PQQs - published in October 2010
and revised (improved) in 2013

•

Covers a range of topics beyond HS

•

The HS questions are based on the CDM ACoP
core criteria – and are set to ‘take over’ from
them

•

Refers specifically to using SSIP members for HS
PQQs – probably the part of PAS 91 that works
best!
PAS 91: the future?
We would like to see:
• PAS 91 become a British Standard
• PAS 91 mandated for use across all public sector
construction
• Wider take-up in business sector

• suppliers able to be assessed against the Standard
Benefits of PAS 91 should include
Suppliers
• Fewer duplicate/different questionnaires - saving time
and money
Buyers
• Confidence a supplier has been assessed to
acceptable core criteria
• Far less effort required to assess the contractor’s basic
responses
• More choice of suppliers
PQQs: what else do we need?
• a national e-system that allows suppliers to upload
and update their information (once)

• a national portal - so buyers can easily see the PAS
91/SSIP status of suppliers
• buyers asking for evidence of ‘SSIP member
assessment’ (not individual scheme assessment)
• ‘additional assessment requirements’ commercially
transparent – and why not optional!!
Thanks for listening…
Afternoon seminar session
12:30pm – 2:00pm
Supply Chain Sustainability School with Kier
Unlocking new business opportunities for sustainable suppliers
London Construction Programme
Engaging with London Construction programme
London Procurement Network
Sourcing suppliers: Supporting the SME
The Supply Chain
Sustainability School
Wendy Carwardine
School Manager
www.actionsustainability.com
www.supplychainschool.co.uk
Peter Johnson
Kier Group Environmental Manager
“This way David; I can see the light at
the end of the recession”
1
0
2

Ethical Business Module 1
Some Good News
Construction output is expected to
rise by 3.4% in 2014 and by a further
5.2% in 2015
Growth is projected to continue
throughout the forecast period, to
2017
Construction Products Association
13th January 2014
1
0
3

Ethical Business Module 1
10
4

Ethical Business Module 1
“Never before have companies been
scrutinised so rigorously in terms of their CR
performance. We are only too aware of the
role that CR now plays in our ability to win
new work, and the economic benefits of a
sound investment in CR are clear”
Paul Sheffield
CEO
Kier Group plc.
2013

10
5

Ethical Business Module 1
10
6

Ethical Business Module 1
Sustainable procurement
Public sector spending is worth
approximately 16% of the UK’s Gross
Domestic Product (GDP). Central
government alone buys the equivalent
of 9% of GDP
“The public sector can use this buying
power to encourage suppliers to make
their products and services sustainable”
“It can also use its buying power to
make the way contractors carry out
works sustainable”
Defra December 2013
11
0
The Employer takes Sustainable Development and environmental performance
seriously. Please describe the approach you will take to identifying Sustainable
Development and environmental risks/opportunities for new build and
refurbishment projects
11
3

Ethical Business Module 1
11
4

Ethical Business Module 1
“A sustainable construction
supply chain is only as strong
as its weakest link –
your participation in the
School will ensure
that there are no
weak links”
50%
less time

50%
33%
Less cost

less CO2
• 2,102 company members
• 3,874 individuals members
What is the the Supply Chain School?
 a virtual learning environment that aims to help
construction suppliers and sub-contractors to develop their
sustainability knowledge and competence
 making us all better able to address the challenges our
industry face
 and importantly to help suppliers benefit from the many
new business opportunities that are emerging for
businesses who understand this agenda
So what is the school?
Prioritisation
Process

Engagement
Method

Self
Assessment
Tool

Web
resource
portal

Bespoke
Action Plans
Role of the School
 Main contractors manage supply chain performance, this includes
everything necessary to fulfill their own corporate and project specific
objectives
 The School manages supply chain competence, this is a combination of
knowledge, skills and behaviour
 The contractors and the School jointly manage engagement, this includes
all the activities necessary to ensure the supply chain uses its
competence to deliver the appropriate level of performance,
 The industry wide leadership group monitor and assure the performance
of the School.
Self assessment
Action plan
A wealth of sustainability resources
Not just online – over 50 events
Supplier dashboards
Supplier dashboards
Supplier dashboards
Key principles
 Its voluntary
 Carrot not stick
 Its not pre-qualification
 Supplier driven - develop at own pace
 Based on trust

 Its confidential to each supplier
 Free at the point of use: lots of free resource
So get online and get registered . . .
Wendy Carwardine
School Manager
www.actionsustainability.com
Working Together BUILDS Better Results
London Construction Programme (LCP)
Contractors Frameworks
1.Introduction to LCP

2.LCP Strategy
3. Overview and the proposed Major Works Contractors
and Specialist Contractors Frameworks

4.How?
5.Programme (Approximate)
6.Next steps
7.Summary
8.Questions
Introduction (cont’d)
• The London Construction Programme (LCP) was established
by a group of local authorities in London, supported by Capital
Ambition/London Councils, to develop a pan-London strategy
to improve construction procurement.
• LCP offers framework agreements, contracts and category
management support to deliver construction projects more
efficiently and effectively.
• LCP aims to cut the cost and risk of localised procurement and
achieve better value for money outcomes from construction
projects through collaboration.
Introduction (cont’d) –
Capital Ambition
• Capital Ambition sponsored a review of
Construction across London Local
Government
• Summary report identified a need for
improvements, effective collaboration
and better alignment to the National
Strategy
• The London Construction Programme
(LCP) - initiated by Haringey, Barnet and
Enfield with the first Pan London
framework for Consultants
Introduction (cont’d)
• LCP does this by:
• co-ordinating the overall strategy for London’s public sector
in order to maximise outcomes and benefits and avoid
duplication of effort
• leveraging the combined buying power of London’s public
sector and associated buying organisations
• making available collaboratively procured Framework
Agreements and contracts along with shared category
management support as a value-adding resource to client
organisations and a centralised market to
consultancies, contractors and suppliers
Introduction (cont’d)
• A virtual organisation of partners
Haringey, CCS, LHC, IESE, SCMG,
• Established for the benefit of all public sector in London (excl
Central Govt departments)
• Work-programmes are jointly agreed and monitored
• Any public sector body in London can take part.

• Broader agenda of best practice, common
specifications, standardisation, efficiency, KPI’s, templates etc.
London Construction Programme (LCP)
- Introduction
• Position of London regarding
construction - one of six key
streams of work.
and
• Delivery of various framework
agreements against a much
broader agenda of best
practice, standardisation,
efficiency etc.
LCP Strategy
LCP’s strategy is :
• for London’s public sector authorities and buying organisations to
work collectively to achieve higher benchmarks using their
respective strengths and combined resources, minimising
duplication of effort and maximising value for money.
• make available a suite of pan-London construction-related
Framework Agreements
• establish a range of shared services and resources for class-leading
procurement and performance management.
• enable access to expert knowledge and experience within LCP
participating organisations.
LCP Strategy
To draw the London public sector “together” through:
•
•
•
•

Embedding Consultants framework (CRCS2012)
To develop the Contractors frameworks.
To develop Materials and Supplies frameworks
To establish a group of key stakeholders (Project
Board) to help drive the agenda and to share
the burden - LHC, CCS, SCMG, IESE plus
• Advisory Panel of interested authorities.
• To align area procurement eventually and cycle
key frameworks during the term.
Introduction –
The Economic Environment
• Extremely challenging for everyone
involved in construction projects
• Public Sector suffering reduced budgets
which has a direct impact on our
suppliers
• Local Govt is currently investing far more
in construction than the private sector &
thus remains an important client
• Everyone is expected to achieve more
with less
Introduction (cont’d) –
LCP’s philosophy and approach
Objective

Approach

• Take down barriers to
efficiency

• Avoid duplication through flexible
frameworks

• Enable clients to input into
the design of frameworks
• Enable suppliers to engage
early in the delivery
planning
• To be an exemplar initiative
connecting resources for the
benefit of public sector
clients

o Save time & money, define quality, offer
choice

• One stop shop for procurement
o Portal, signposting pre-prepared
frameworks, market transparency, risk
managed approach

• Standardised procurement
process, common OJEU and KPIs
o Simplifies, cuts cost, re-focuses team
energy on project outcomes
Introduction –
Direction of travel for LCP
Bring together organisations with the capability/capacity to take a lead role
in providing new procurement solutions for London’s public sector
Invite people to lead innovation on behalf of a collective
client base
Align our approach to make procurement simpler, faster and
more productive for both clients and suppliers

Anticipate multi-layered solutions: Pan
London; Sub Regional, Local Clusters
(LCP co-ordinated)
LCP Strategy (cont’d)
• LCP’s strategic aim is for London’s public sector
authorities and buying organisations to work
collectively to achieve higher benchmarks using their
respective strengths and combined
resources, minimising duplication of effort and
maximising value for money.
LCP Strategy (cont’d)
• LCP’s strategy is to:
• make available a suite of pan-London constructionrelated Framework Agreements
• establish a range of shared services and resources
for class-leading procurement and performance
management.
• enable access to expert knowledge and experience
within LCP participating organisations.
LCP Framework pipeline

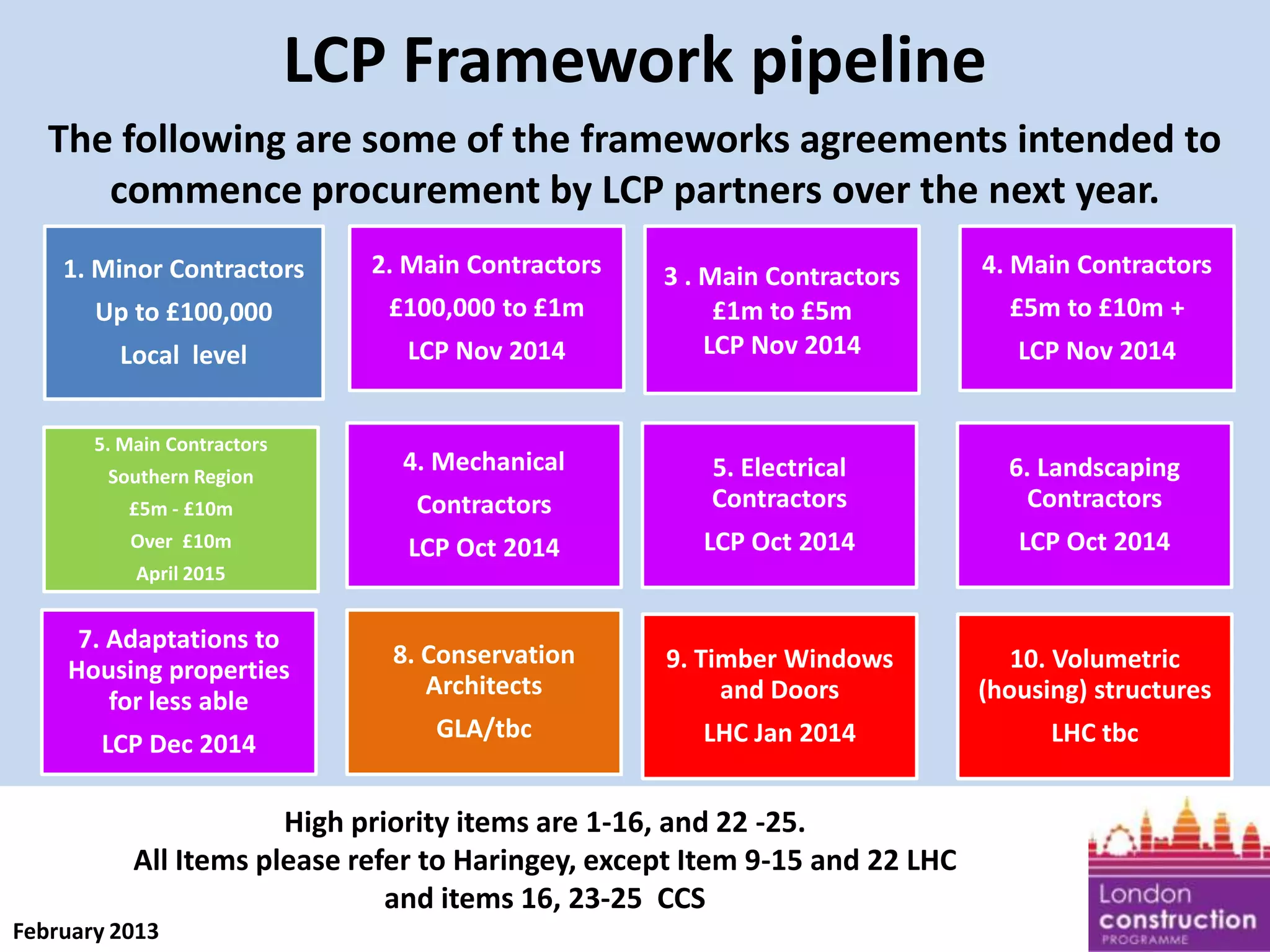

The following are some of the frameworks agreements intended to
commence procurement by LCP partners over the next year.
1. Minor Contractors

2. Main Contractors

Up to £100,000

£100,000 to £1m

Local level

LCP Nov 2014

5. Main Contractors

4. Mechanical

3 . Main Contractors
£1m to £5m
LCP Nov 2014

4. Main Contractors

6. Landscaping
Contractors

£5m to £10m +
LCP Nov 2014

£5m - £10m

Contractors

5. Electrical
Contractors

Over £10m

LCP Oct 2014

LCP Oct 2014

LCP Oct 2014

8. Conservation
Architects

9. Timber Windows
and Doors

10. Volumetric
(housing) structures

GLA/tbc

LHC Jan 2014

LHC tbc

Southern Region

April 2015

7. Adaptations to
Housing properties
for less able
LCP Dec 2014

High priority items are 1-16, and 22 -25.
All Items please refer to Haringey, except Item 9-15 and 22 LHC
and items 16, 23-25 CCS
February 2013
LCP Framework pipeline
Please refer for latest updates and further details to the pipeline on
the website http://lcp.g2b.info/frameworks/

LHC 2015

13. Asbestos
Surveyors

14. Asbestos
Contractors

15. Building
Insulation

LHC 2015

11. Gas Servicing

12. Communal
entrance doors and
door entry systems

LHC Feb 2014

LHC Feb 2014

LHC 2015

19. Demolitions

20. CCTV

tbc

tbc

24. Building
Materials

25. Project
Management and
Full Design

16. Commercial
Catering &
Refrigeration

17. Lift
installations &
maintenance

CCS Nov 2014

tbc

21. Conservation
Works

22. New Build Extensions
and General Refurbishment
Works for Schools and
other community buildings

tbc

LHC - Expires 30th June
2017

18. Stairlifts
installation, servicing
and maintenance
(Fusion 21)

23. Estates
Professionals
CCS - Expires 31st
March 2017

CCS April 2014

N.B. Please note this is only an indication of intended
frameworks. These may or may not be put in place.
February 2013

CCS April 2014
LCP Framework pipeline

Please refer for latest updates and further details to the pipeline on
the website http://lcp.g2b.info/frameworks/
Consultants

Main Contractors

CRCS2012

IESE

LCP
Expires 29th Feb 2016

Expires April 2015

Architects, Design and Urban
Planning
GLA Nov 2013

N.B. Please note this is only an indication of intended
frameworks. These may or may not be put in place.
February 2013
Authorities position for CRCS 2012
Enfield

Barnet
Harrow

Haringey

Brent

Hillingdon

Waltham
Forest

Redbridge
Havering

Camden
Tower
City Hamlets

Ealing

Newham

Barking &
Dagenham

Greenwich
Hounslow

Bexley

Richmond

Wandsworth

Lewisham

Merton
Kingston

Bromley
Sutton

Signed up

Croydon

London-wide organisations
LFB

Metropolitan Police
Other mechanisms in place
LCP Contractors Frameworks
•
•
•
•
•

•
•
•

To be EU Compliant.
To have easy access to market
Collaboration between authorities
Pan London – (procurement
efficiency)
Standardisation of process and
contract documentation.
KPI’s drawn from National level
Link to National Agenda.
Be flexible.
LONDON
CLUSTER

100k to £1m
< £100k

Southern
Framework

LONDON
CLUSTER

£1m to £5m

LONDON
CLUSTER

£5m to £10m +

LOCAL

Minor
Works

LCP Major Works

> £10m

USE IESE UNTIL 2015

LCP Contractor Frameworks

Turnover
values and
number of
contractor in
each value
band to be
agreed
LCP Contractors Frameworks
• Aggregation of
effort, resource and
spend
• Standardise
procurement, design and
delivery
• Common specifications
where possible
• Share best practice
• Achieve efficiencies
Overview - Contractors /Specialist contractors
• Developing various Frameworks

• Major contractors
• Specialist
–
–
–
–

Mechanical
Electrical
Landscaping
Housing adaptations for the less able
Overview
• The list of Public Bodies that may use the Contractors
Frameworks will be referred to through the advert and the
Memorandum of information.
• Standard OJEU has been developed for adverts.
• The Framework Agreement will be open predominantly to
Local Authorities within London
• Could include Police Authorities and Fire Authorities, and
Primary Care Trusts associated with the Local Authorities.

• Any faith educational establishments, associated with the
named Local Authorities.
Overview (cont’d)
All registered Social Landlords (as defined in Part 1 of the
Housing Act 1996) and their agents within the geographical area
of London includes all ALMO’s or any successor body of the 33
Local Authorities within London.
It will also include any bodies previously covered by these
Authorities such as “free schools” and academies, further
education, and any Trusts, Social Enterprises, Mutuals, and
Community Interest Companies that are within the 33 Local
Authorities within London and the contracting Authorities are
trustees or partners of the Social Enterprises, Mutuals and
Community Interest Companies or any similar organisation
formed within the community.
Other Public Sector Organisations.
Overview – Major Works
The types of projects anticipated in this framework include, but
are not limited to:
•new build construction works;
•planned maintenance either capital and revenue projects;
•adaptations;
•refurbishments;
•improvements
•regeneration works;
•extensions etc
Could be defined lots for Housing (S20’s) and Education etc.
Overview - Specialists
• The types of projects anticipated in the framework
include, but are not limited to:
• planned maintenance either capital and revenue projects;
• some reactive
• Boiler replacements etc
• Electrical Rewiring
Overview - Specialists
• The types of projects anticipated in the framework
include, but are not limited to:
• Hard and soft Landscaping
• Playgrounds/MUGAs etc
• Housing adaptations for less able to public and private sector
associated with Disabled Facility Grants etc
How?
• Clusters approach i.e. East, North, West, South
West, South East,
• Note:- certain areas have own frameworks to join later
in life of Frameworks
• Contractors will need to apply for each area.
How (cont’d) - London Regions
North

West

East
Enfield

Barnet
Harrow

Haringey

Brent

Hillingdon

Waltham
Forest

Redbridge

Camden

Barking &
Dagenham

Tower
City Hamlets

Ealing

Newham

Greenwich
Hounslow

Bexley

Richmond

Wandsworth

Havering

South East

Lewisham

Merton
Kingston

South West

Bromley
Sutton

Croydon

London-wide organisations
LFB
Metropolitan Police

Proposed London Regions (to be confirmed)
How – benefits?
•
•
•
•
•

To be created by London Authorities for London Authorities
Collaborative working
Centralised monitoring of the framework agreement
Templates available for appointment etc
Standardisation of policies – Apprentices etc, local labour,
Timber policy
• Key Performance Indicators
• Different forms of contract can be used – JCT suite, PPC 2000
etc, NEC3
• Flexibility of Procurement routes, Two stage D and B, D and B,
trad etc
How – Benefits?
•
•
•
•
•
•

Points of contact for help for Local Authorities
Standard approaches
Regular performance reviews with the Contractors
Key objectives to be defined
Work across a variety of sectors
Projects of varied types can be procured through the
framework
• Information packs for contractors
How – stages?
• Stage 1
• Scoping - Questionnaires with Clients
• Stage 2
• Soft Market testing with contractors
How - stages?
Stage 3
• PQQ- to be defined using constructionline and PAS 91 where
possible same for all lots (variances for values and types of
work)
Stage 4
• Full EU advert
Programme – Major Works
• Soft Market – May/June 2013.
• Advert - February 2014
• Tender – May/June 2014

• Mid Tender reviews – webinars – May 2014
• Award December 2014/January 2015 for four years
• NB – Allow for section 20 process (Haringey and
others)
•
In summary
• LCP is comprised of organisations
that want to collaborate & achieve
efficiencies
• LCP frameworks will be supported by
the lead authority
• LCP is open to all public sector
organisations in London
• Major works and specialists
contractors frameworks
Further Information
Website :
http://lcp.g2b.info

Website includes pipeline of LCP
frameworks that maybe
procured with partners.
Frameworks that can be
currently accessed.
Next Steps

Contact

LCP@haringey.gov.uk
020 8489 1037 or
1073/1272/1070
Questions
Sourcing Suppliers – Supporting the SME
Constructionline “Meet the Buyer” Event

Terry Brewer, Divisional Director, Commercial, Contracts & Procurement,
Harrow Council and Chair of London Heads of Procurement Network.
Agenda

• Procurement drivers and trends
• National picture – CCS and Local
Government
• FSB survey
• Construction related issues
• What we are doing for SMEs
Procurement Drivers
• Reducing budgets – ‘graph of doom’
• Need to maintain statutory services
• Desire to generate “social value”
from public procurement
– Including government objective to
create opportunities for small
businesses
– and even when not legally required by
the Public Services (Social Value) Act
2012
Procurement Trends
• Better resource efficiency
– in terms of money, energy, materials, time etc

• E-everything
– Procurement, contract management, communication

• Decentralisation
– e.g. Schools becoming independent Academies

• Local authorities working together, more
– including use of national and regional frameworks and
systems such as
Constructionline
National position: Changes to EU legislation
• Revised EU regulations will make it faster, easier and cheaper
for small firms to bid
• Changes include:
– Not needing to provide extensive supporting evidence – only successful
bidder will need to do so
– Not needing to provide 3 years accounts – will only need revenue to be twice
value of deal
– Clarification re breaking down requirements into ‘Lots’

• Timetable
– EU adoption expected this month
– Govt seeking to tranpose within 7 months
National Position – what is CCS doing?

Introduced the
Crown
Representative
for SMEs – they
have a voice at
the top table

Developing tools
to make it easier
to find
opportunities to
do business with
Government –
Contracts Finder,
Solutions
Exchange

Reformed the
procurement
process
‘removing
barriers’ –
abolished PQQ
below
threshold, LEAN

SMEs given new
channels of
communication
including Mystery
Shopper and SME
Panel

Lead ministers
and SME
Champions
appointed.
Departmental
SME plans with
specific targets
for spend with
SMEs

Big is not always
beautiful –
Optimal contract
size
Optimise lotting
structure
Getting the best
bidders bidding
What is the LGA doing?
• LGA is taking a category management approach to the spend
nationally in local government
• 3 categories being supported in first wave – ICT, Energy and
Construction
• Aim is to have a National Category Strategy for each area
• Part of each category strategy is to set out key issues for
SMEs and how that market should be approached on a
national/regional and local basis
What does the FSB survey say?
• FSB 2013 survey – around half of Boroughs responded
• On average boroughs in London spend 35% of their total
procurement expenditure on SMEs (up from 27%)
• 50% of boroughs seek to pay suppliers within 28 days (up
from 37%)
• 36% of boroughs seek to pass on their payment terms to
main contractors
• Conclusions of survey – need to do more spend analysis,
simplify processes, and more pre-engagement activities
Construction opportunities

Key issues in construction?
Likely construction opportunities
• Design and build of new [social] housing
• Integration of “green” technologies into built
environment and improving its energy efficiency
• Expansion to and new build of schools because of
“pupil bulge”
• Aids and adaptations to homes of elderly and
disabled people
What we need from the construction marketplace

•
•
•
•
•
•
•
•

Quality
Efficiency – reflected in pricing
Getting it ‘right first time’
Innovative solutions
Competition for our contracts
A partnership approach
Honest feedback
Jobs, apprenticeships and training for
our communities
• Improved environmental performance
What we are doing for SMEs
• Reducing down pre-qualification criteria & questions
– And encouraging all procurers to ask similar, simplified
questions eg PAS91 adoption
– And finding ways to avoid asking you for the same information,
in relation to more than one procurement, in a short space of
time eg SSIP model for Health & Safety

• Using “SME friendly” pre-qual systems and portals
– E.g. Constructionline, London Tenders Portal, Compete For

• Creating opportunities for SMEs as 2nd and 3rd tier suppliers
on large projects, through ITT questions and contract
clauses
• Getting ready to adopt new “SME friendly” public
procurement directives
Free opportunities to build your capacity and capability

• CITB “Sustainable Supply Chain School”
– www.supplychainschool.co.uk

• CITB “Be Fair” Framework, guidance and toolbox talks
– http://www.citb.co.uk/employer-support/fairness-inclusionand-respect/

• Coming soon; CITB “Shared Apprenticeship Scheme”
– so that you can employ an apprentice (via the CITB) to work on
a specific package whenever you have the need/ opportunity
– http://www.citb.co.uk/citb-apprenticeships/sharedapprenticeship-scheme/

• Council “Selling to the Council” web pages
e.g. www.harrow.gov.uk
Thank you!

Showcase MTB 2014 seminar sessions

  • 1.
    Morning seminar session 10:00am– 12:00pm Lend Lease Elephant and Castle - why it's different Trading for Good How to differentiate your organisation and win business McLaughlin & Harvey 'Effective partnering, efficient procurement’ ECA PAS 91 and SSIP - the practical benefits for buyers and suppliers
  • 2.
    The Elephant andCastle - why it is different
  • 3.
  • 12.
    •How Did Weget here? •Our vision is to re-establish •Elephant & Castle as one of London’s •most flourishing urban quarters. We are working in partnership with Southwark Council in a £1.5billion transformation in the heart of Elephant & Castle Elephant & Castle by 2025
  • 13.
    We have threesignificant ambitions 01 Improve quality of life 02 03 Set a new standard for urban development Enrich the environment and the community
  • 14.
    Part of the ClintonClimate Positive Development Program £30million Safer streets contribute to improvements to roads, public transport, pedestri an and cycle routes with improved lighting and more publicly accessible areas to create a high quality and safer environment 1,600 trees either retained or newly planted – increased biodiversity onsite and in wider area Net 0 6 new parks & 10 public squares Carbon growth 2025 Planning / Demolition Construction schedule
  • 15.
    The facts: Completion expected Over £1.5million contributedto local schools 2025 Up to 5,372m2 of new office space Over 50 new shops, restaura nts, cafes and bars 7,000 jobs & £2.5m+ into local training and employment Nearly 3,000 new homes, min. 25% affordable
  • 16.
    What Makes Elephantand Castle Different – Healthy Living and Healthy Environment Local community – healthy, safe and vibrant Economic growth – jobs, skills and opportunity Energy and efficiency – smart design and technology Energy sources – low carbon heat and electricity Wellbeing – healthier living in the heart of London New parkland – landscaping and species diversity Shared infrastructure – leading edge services Social – diverse range of activities Transport – promotion of sustainable transport Waste – minimise and recycle Healthy innovation – low carbon materials Water – reduce water consumption by 30% vs typical UK standards
  • 17.
  • 18.
  • 19.
    Phasing/Indicative Plot ConstructionProgrammes Indicative Plot Construction Programme Calendar Year: Demolition 2013 2014 2015 2016 2017 2018 2019 2020 2021 July 2013 2022 2023 2024 2025 Heygate Demolition Plot H13 (72 units) Plot H10 (75 units) Masterplan Phase 1 MP1 Plot H6 (168 units) Plot H12 - Energy Centre Masterplan Phase 2 Plot H3 (181 units) MP2 Plot H2 (347 units) Masterplan Phase 3 Plot H7 (347 units) + 50% park MP3 Plot H4 (349 units) 50% Park Completed Masterplan Phase 4 MP4 Plot H1 + 50% Park (256 units) Park Completed Plot H5 (286 units) Masterplan Phase 5 MP5 Plot H11a (166 units) 19 2469 2247 2081 1795 1539 1190 843 496 72 Indicative Cumulative Resi Unit Completions (Outline Illustrative Masterplan) 315 Plot H11b (222 units) & Heygate Street
  • 20.
  • 21.
  • 22.
    Local Employment OBJECTIVES Finding theJobs DETAIL • Jobs secured through contractual relationships with the supply chain •Encourage and enable local companies to invest in local jobs •Case studies used to inspire future companies • Create an inclusive network of organisations who will assist us in finding the best people Finding the People Pre Employment •Actively engage with “Southwark Works” to create a collaborative borough wide approach to employment •Using social media to find local people who are disengaged • Prepare people for success , Building Confidence, skills, stamina, and ability •Identifying the skills gap and providing suitable courses to address the need •Uncover organisations and companies who will develop and deliver short courses LONG TERM VISION Local Procurement Local Procurement Equality Sustained Employment • • • Developing skills and resilience to achieve full potential Creating an aspiration for personal development Providing a culture to deliver a career pathway 22
  • 23.
    Local Spend Definition ofLocal Spend Targets: Diverse Suppliers 20% Aiming for a baseline of 20% diverse or local suppliers Increase opportunities for companies with the entire supply chain in consultation with the councils resources and deliver regular meet the buyers events in relation to the development timed to coincide with contract tenders and targeted at SME’s based in the borough in order to make them aware of the opportunities, timescales and procedures to be adopted for tendering for relevant procurement opportunities. • A benchmarking target of 20% local procurement for the project which will drive our commitment in this area
  • 24.
    Diversity OBJECTIVES DETAIL • LL createsan inclusive culture to demonstrate the benefits of diversity Leadership •Use case studies to prove the point •Inspire the business to improve on our aspirations • Targets set for BME, LP, WOM, PWD, 50+ and Low Skill Targets •To be driven down the supply chain •Reported on a quarterly basis • Supply Chain Engagement Train the Supply Chain to engage in the subject (Be FaIR Framework) • Promote the full diversity agenda with the supply chain during the procurement process • Use BeOnsite as a vehicle for change LONG TERM VISION Local Procurement Supplier Diversity Local Procurement Equality • • • Actively source local companies via the EOI site Advertise locally to encourage engagement Hold regular “Meet the Buyer” events 24
  • 25.
    Skills Academy Topics toinclude:Attend Short Courses 14-16 year old work placements 16-19 year old work placements Graduate Recruitment Curriculum Support Events with Schools Training Plans with Sub Contractors Leadership and Management Training with Supply Chain Advanced H&S Training with the Supply Chain Supply Chain Briefings Individual People Skills Profile Business Skills Diagnostic Support Support and Advice for S/C Summer Placements 14- 25 year olds Further Education Site Visits Higher Education Paid Work Placements Research Opportunites Functional / Basic Skills for New Recruits Pre Employment Courses ESOL Courses Attend School Activity Days Site Visits by Local Schools Basic / Functional Skills for Exisitng Workforce Diversity Training for Existing Workforce
  • 26.
    Targets OBJECTIVES DETAIL • OTE 33 BeneficiaryStarts (6 Months) • TP 29 •MP 397 • OTE 15 NVQ’s Apprencticships • TP 13 •MP 149 •OTE 14 Short Courses (Basic Skills and Construction Skills) • TP 25 •MP 276 LONG TERM VISION Local Procurement Local Other Equality Procurement • • • CCI Skills Academy BE FaIR Framework and the Respect Campaign 26
  • 27.
    We want tohear from you if? • You have a presence within Southwark • You have a unique product which delivers an innovation against current practice • You have the ability to co invest in the local community
  • 28.
    Established to helpSMEs build their businesses Embracing best practice Leveraging the good work you do to win more business Headline Sponsor: 28
  • 29.
    The Old Playground •Social Value Act 2012 – Chris White MP • Public sector tenders now need to demonstrate the social value a business generates • In various ways this is and will continue to emerge in the private sector • Prime contractors working for government are increasingly looking to demonstrate social value in the supply chain Headline Sponsor: 2
  • 30.
    Social Value –What is it???? Anything from simple sponsorship of a local school fete… How you look after your staff – health and wellbeing How you work with young people, apprentices for example How you work with your environment – recycling to how you procure your goods and services Volunteering, charitable giving Headline Sponsor:
  • 31.
    You are probablyalready generating social value, we want to encourage more and help you win more business by shouting about the values you have Headline Sponsor:
  • 32.
    What is Tradingfor Good Originally a number 10 initiative, it is now a not-for-profit limited company, Central to TFG is our online service, a website dedicated to helping SMEs share knowledge, shout about the good work they do, provide information and crib sheets to help you do more Headline Sponsor:
  • 33.
    An exciting newfree digital service, designed exclusively to help small businesses grow by promoting all the good work that they do. Headline Sponsor:
  • 34.
  • 35.
    Still early stages,but in building this to the critical mass required we are reliant on you engaging, a leap of faith for some but a proven path for many Headline Sponsor:
  • 36.
    Social Value Reports TFGalso provides big corporates with social value reports, using a sample of a company’s supply chain we build a picture of the good responsible work they do. Carillion has asked us to produce one for them…which in turn means they will be continually seeking to procure goods and services from businesses who can show the benefits they bring to staff and their community, or indeed society at large. They wish to be market and thought leaders in this space, but they are not alone, most big corps who also wish to win Government business will do the same, or already are Headline Sponsor:
  • 37.
    Ambitions: • To createthe UK’s most recognisable brand for responsible business • To connect the brand of T4G to good business directories • To become the trusted hub of information for SME’s on responsible business practice • Generate data on key issues – reports to BIS • Enable the public to easily see what an SME is doing locally • Inspire peer to peer examples • Prompt consumer behaviour to purchase locally / responsibly Headline Sponsor:
  • 38.
    What can youdo? • Register: @ • www.tradingforgood.co.uk • Recognise the good work you are already undertaking and build on it • Use these values in your marketing, communications, internal and external • Where can you do the most good while doing well? Work experience, apprentices, be exceptional, extraordinary, stand out!!! Headline Sponsor:
  • 39.
  • 40.
    Introduction The Company Current andRecent Work Future Opportunities Procurement – How We Work In Partnership with Constructionline
  • 42.
    Hands on Approach MAINBOARD MANAGING DIRECTOR Philip Cheevers FINANCE DIRECTOR Stephen Hamill PROCUREMENT COMMERCIAL CIVIL ENGINEERING DEPARTMENT CONSTRUCTION FACILITIES MANAGEMENT JOINERY & FRAMEWORKS QUALITY / ENVIRONMENTAL ADMINISTRATION DIRECTOR Alan Coulter DIRECTOR Martin Scott DIRECTOR John Glass DIRECTORS David Larmour Alan McKee Michael Kieran DIRECTOR Richard Cheevers DIRECTOR Richard Cheevers MANAGER Richard Robinson DIRECTOR / COMPANY SECRETARY Patrick Buchanan Marketing Planning Estimating Purchasing Quantity Surveying Cost & Bonus Surveying Civil Engineering Works & Design Building Construction Programming Construction Plant Service Department Health & Safety Labour Relations Facilities Management Small Works Help Desk Joiners Shop Frameworks Workshop Quality Control Environmental Management Sustainability Accounting Legal/Insurance Personnel Computer Management Services
  • 43.
    Capabilities Building Construction Civil Engineering FacilitiesManagement & Small Works Fit-Out Offshore & Onshore Sustainable Energy Aluminium Windows & Curtain Walling
  • 45.
  • 46.
    Loch Ryan Terminal,Cairnryan £57 million
  • 47.
  • 48.
  • 49.
    Royal Victoria Hospital,Belfast £120 million
  • 50.
  • 51.
  • 52.
  • 53.
  • 54.
  • 55.
  • 56.
  • 57.
  • 58.
    St Columba’s HighSchool Slide 19
  • 60.
  • 61.
  • 62.
    Peacocks Walk, Woking PrincipalContractors Frameworks Commercial Way, Woking Little Heath School, Tilehurst Dunstable College Ryvers School, Slough M&S, Bristol & Harrogate House of Commons M&S, Berkhamstead Russell Lower School, Bedfordshire Primark, Camberley Selfridges, Oxford Street Hillbrook Primary School, Wandsworth
  • 64.
  • 65.
    Health & SafetyStandards • OHSAS 18001 • Health & Safety Training for all Staff • Contract Specific Site Inductions • Careful Selection & Monitoring of Subcontractors • Risk Assessments & Method Statements • Health & Safety Inspections & Audits • In-house Health & Safety Team • KPI’s
  • 66.
    Health & SafetyCultural Journey
  • 67.
    Health & SafetyAwards • RoSPA Occupational Safety Awards: • 2013 Gold • 2012 Gold • 2011 Gold • 2010 Silver • British Safety Council International Safety Awards: • 2013 Merit • 2012 Merit • 2011 Merit • 2010 Pass • National Irish Safety Organisation / Northern Ireland Safety Group Occupational Safety Prestigious Award 2011
  • 70.
    Procurement • Based inBelfast DIRECTOR ALAN COULTER MARKETING BUSINESS DEVELOPMENT MANAGER PURCHASING ESTIMATING COMMERCIAL MANAGERS (8) ESTIMATORS (14) PLANNER (1) BUYERS (6) ADMINISTRATION (2)
  • 71.
    Pre-qualification • Avoid Duplication& Administration Costs • Constructionline – PAS91 • Safety Standards in Procurement
  • 72.
    Subcontractors & SupplyChain • • • • Estimating Buying E-zines Constructionline Opportunities Board
  • 73.
    • Strong robustbusiness • Diverse range of projects • Commitment to price • Nationwide coverage • Constructive Dialogue • Support local sub contractors • ‘Right place, right time’ • Clear Subcontracts & Orders • Prompt Payment • Long Term Relationships
  • 75.
  • 76.
    Why Constructionline? • • • • Nationwide Database RegionalEvents In touch with Government Construction Strategy Helping drive down paperwork in pre qualification • Dedicated point of contact • Support staff
  • 78.
    SSIP and PAS91 Benefits for Buyers and Suppliers Paul Reeve CFIOSH CEnv FIEMA Director of Business Services, ECA
  • 79.
    Aims of thispresentation To outline: - what SSIP and PAS 91 are - how they help buyers and suppliers - what we need from them in future...
  • 80.
    Quick background toSSIP SSIP was launched in 2009 against backdrop of: • Mushrooming HS assessment schemes /company PQQs, claiming to provide ‘the best answer to PQQ’ etc. • Broad realisation that the safety pre-qualification landscape imposes unnecessary costs on suppliers • Several SSIP member schemes agreed to use common (core) pre-qualification criteria, based on the HSE’s CDM 2007 ACoP.
  • 81.
    Core criteria areessential… • The MCG (now UKCG) drafted pre-qualification ‘core criteria’ for construction in the early 2000s • ECA and HVCA (now B&ES) launched HSE-backed core criteria in 2006 – based on common good practice and basic legal requirements. Similar core criteria then appeared in the CDM 2007 ACoP • Enter SSIP - HSE worked with SSIP to ensure SSIP assessment criteria agreed with the core criteria • In 2010 PAS 91 (construction PQQs) adopted the core criteria…
  • 82.
    SSIP scheme recognition Crossrecognition • If a supplier has been successfully assessed by one SSIP member, then that assessment should be suitably (ideally fully) recognised by the others* One way recognition • E.g. schemes recognise OHSAS 18001 from a UKASaccredited SSIP member certifier – this part works particularly well… *though there may be an administrative fee
  • 83.
    What is cross-recognised? •The suppliers’ basic HS capability only • CDM core criteria ‘Stage 1’ only • Stage 2 (project-specific questions) is the buyer’s responsibility These questions depend on circumstances, so they cannot be standardised for desktop assessment.
  • 84.
    Savings due toSSIP Three key questions are: 1. What type of savings does it deliver? 2. How big are those savings? and 3. Who benefits from them?
  • 85.
    Benefits of SSIP:to suppliers • Fewer duplicate/different questionnaires - saving time and money (feedback from schemes and TAs shows this is happening) • Suppliers are most concerned about the time it takes to engage with PQQs • ‘Deemed to satisfy’ (cross-recognition) delivered at least £10 million in savings to suppliers in 2013
  • 86.
  • 87.
    Deemed to satisfy? Ofthe myriad SSIP schemes: 85% of the known savings came from DTS provided by just four schemes… …and nearly 75% from just two.
  • 88.
    More to thisthan DTS… • DTS is one indicator of savings, but it can be misleading • DTS is an indicator of the problem… • Savings to both buyers and suppliers also come when a buyer: • simply asks for ‘SSIP member’ assessment • can easily check a supplier’s assessment
  • 89.
    Benefits of SSIP:to buyers • Confidence a supplier has been assessed to the core criteria • Less time and effort required to assess a contractor’s/consultant’s basic responses • More choice of suppliers (when seen as an advantage!)
  • 90.
    The SSIP Portal • Centralverification database – lists 10,000s of contractors assessed by SSIP members • Verifies that a contractor holds current SSIP member assessment/certification • • Reduces PQQ time, effort and duplication £100 per annum for buyers to search the portal Free to bona fide buyers by Q2 2014? www.ssipportal.org.uk
  • 91.
    Safety Schemes inProcurement… … is not the perfect supply chain solution to HS prequalification problems* But it is (demonstrably) a solution – for basic HS PQQs, still the ‘best game in town’ However, the pressure is building up for SSIP to deliver much more…
  • 92.
    Quick background toPAS 91 • Effectively the draft Standard for basic construction PQQs - published in October 2010 and revised (improved) in 2013 • Covers a range of topics beyond HS • The HS questions are based on the CDM ACoP core criteria – and are set to ‘take over’ from them • Refers specifically to using SSIP members for HS PQQs – probably the part of PAS 91 that works best!
  • 93.
    PAS 91: thefuture? We would like to see: • PAS 91 become a British Standard • PAS 91 mandated for use across all public sector construction • Wider take-up in business sector • suppliers able to be assessed against the Standard
  • 94.
    Benefits of PAS91 should include Suppliers • Fewer duplicate/different questionnaires - saving time and money Buyers • Confidence a supplier has been assessed to acceptable core criteria • Far less effort required to assess the contractor’s basic responses • More choice of suppliers
  • 95.
    PQQs: what elsedo we need? • a national e-system that allows suppliers to upload and update their information (once) • a national portal - so buyers can easily see the PAS 91/SSIP status of suppliers • buyers asking for evidence of ‘SSIP member assessment’ (not individual scheme assessment) • ‘additional assessment requirements’ commercially transparent – and why not optional!!
  • 96.
  • 97.
    Afternoon seminar session 12:30pm– 2:00pm Supply Chain Sustainability School with Kier Unlocking new business opportunities for sustainable suppliers London Construction Programme Engaging with London Construction programme London Procurement Network Sourcing suppliers: Supporting the SME
  • 98.
  • 99.
  • 100.
  • 101.
    Peter Johnson Kier GroupEnvironmental Manager
  • 102.
    “This way David;I can see the light at the end of the recession” 1 0 2 Ethical Business Module 1
  • 103.
    Some Good News Constructionoutput is expected to rise by 3.4% in 2014 and by a further 5.2% in 2015 Growth is projected to continue throughout the forecast period, to 2017 Construction Products Association 13th January 2014 1 0 3 Ethical Business Module 1
  • 104.
  • 105.
    “Never before havecompanies been scrutinised so rigorously in terms of their CR performance. We are only too aware of the role that CR now plays in our ability to win new work, and the economic benefits of a sound investment in CR are clear” Paul Sheffield CEO Kier Group plc. 2013 10 5 Ethical Business Module 1
  • 106.
  • 108.
    Sustainable procurement Public sectorspending is worth approximately 16% of the UK’s Gross Domestic Product (GDP). Central government alone buys the equivalent of 9% of GDP
  • 109.
    “The public sectorcan use this buying power to encourage suppliers to make their products and services sustainable” “It can also use its buying power to make the way contractors carry out works sustainable” Defra December 2013
  • 110.
  • 111.
    The Employer takesSustainable Development and environmental performance seriously. Please describe the approach you will take to identifying Sustainable Development and environmental risks/opportunities for new build and refurbishment projects
  • 113.
  • 114.
  • 116.
    “A sustainable construction supplychain is only as strong as its weakest link – your participation in the School will ensure that there are no weak links”
  • 120.
  • 121.
    • 2,102 companymembers • 3,874 individuals members
  • 122.
    What is thethe Supply Chain School?  a virtual learning environment that aims to help construction suppliers and sub-contractors to develop their sustainability knowledge and competence  making us all better able to address the challenges our industry face  and importantly to help suppliers benefit from the many new business opportunities that are emerging for businesses who understand this agenda
  • 123.
    So what isthe school? Prioritisation Process Engagement Method Self Assessment Tool Web resource portal Bespoke Action Plans
  • 124.
    Role of theSchool  Main contractors manage supply chain performance, this includes everything necessary to fulfill their own corporate and project specific objectives  The School manages supply chain competence, this is a combination of knowledge, skills and behaviour  The contractors and the School jointly manage engagement, this includes all the activities necessary to ensure the supply chain uses its competence to deliver the appropriate level of performance,  The industry wide leadership group monitor and assure the performance of the School.
  • 125.
  • 126.
  • 127.
    A wealth ofsustainability resources
  • 128.
    Not just online– over 50 events
  • 129.
  • 130.
  • 131.
  • 132.
    Key principles  Itsvoluntary  Carrot not stick  Its not pre-qualification  Supplier driven - develop at own pace  Based on trust  Its confidential to each supplier  Free at the point of use: lots of free resource
  • 134.
    So get onlineand get registered . . .
  • 135.
  • 136.
  • 137.
    London Construction Programme(LCP) Contractors Frameworks 1.Introduction to LCP 2.LCP Strategy 3. Overview and the proposed Major Works Contractors and Specialist Contractors Frameworks 4.How? 5.Programme (Approximate) 6.Next steps 7.Summary 8.Questions
  • 138.
    Introduction (cont’d) • TheLondon Construction Programme (LCP) was established by a group of local authorities in London, supported by Capital Ambition/London Councils, to develop a pan-London strategy to improve construction procurement. • LCP offers framework agreements, contracts and category management support to deliver construction projects more efficiently and effectively. • LCP aims to cut the cost and risk of localised procurement and achieve better value for money outcomes from construction projects through collaboration.
  • 139.
    Introduction (cont’d) – CapitalAmbition • Capital Ambition sponsored a review of Construction across London Local Government • Summary report identified a need for improvements, effective collaboration and better alignment to the National Strategy • The London Construction Programme (LCP) - initiated by Haringey, Barnet and Enfield with the first Pan London framework for Consultants
  • 140.
    Introduction (cont’d) • LCPdoes this by: • co-ordinating the overall strategy for London’s public sector in order to maximise outcomes and benefits and avoid duplication of effort • leveraging the combined buying power of London’s public sector and associated buying organisations • making available collaboratively procured Framework Agreements and contracts along with shared category management support as a value-adding resource to client organisations and a centralised market to consultancies, contractors and suppliers
  • 141.
    Introduction (cont’d) • Avirtual organisation of partners Haringey, CCS, LHC, IESE, SCMG, • Established for the benefit of all public sector in London (excl Central Govt departments) • Work-programmes are jointly agreed and monitored • Any public sector body in London can take part. • Broader agenda of best practice, common specifications, standardisation, efficiency, KPI’s, templates etc.
  • 142.
    London Construction Programme(LCP) - Introduction • Position of London regarding construction - one of six key streams of work. and • Delivery of various framework agreements against a much broader agenda of best practice, standardisation, efficiency etc.
  • 143.
    LCP Strategy LCP’s strategyis : • for London’s public sector authorities and buying organisations to work collectively to achieve higher benchmarks using their respective strengths and combined resources, minimising duplication of effort and maximising value for money. • make available a suite of pan-London construction-related Framework Agreements • establish a range of shared services and resources for class-leading procurement and performance management. • enable access to expert knowledge and experience within LCP participating organisations.
  • 144.
    LCP Strategy To drawthe London public sector “together” through: • • • • Embedding Consultants framework (CRCS2012) To develop the Contractors frameworks. To develop Materials and Supplies frameworks To establish a group of key stakeholders (Project Board) to help drive the agenda and to share the burden - LHC, CCS, SCMG, IESE plus • Advisory Panel of interested authorities. • To align area procurement eventually and cycle key frameworks during the term.
  • 145.
    Introduction – The EconomicEnvironment • Extremely challenging for everyone involved in construction projects • Public Sector suffering reduced budgets which has a direct impact on our suppliers • Local Govt is currently investing far more in construction than the private sector & thus remains an important client • Everyone is expected to achieve more with less
  • 146.
    Introduction (cont’d) – LCP’sphilosophy and approach Objective Approach • Take down barriers to efficiency • Avoid duplication through flexible frameworks • Enable clients to input into the design of frameworks • Enable suppliers to engage early in the delivery planning • To be an exemplar initiative connecting resources for the benefit of public sector clients o Save time & money, define quality, offer choice • One stop shop for procurement o Portal, signposting pre-prepared frameworks, market transparency, risk managed approach • Standardised procurement process, common OJEU and KPIs o Simplifies, cuts cost, re-focuses team energy on project outcomes
  • 147.
    Introduction – Direction oftravel for LCP Bring together organisations with the capability/capacity to take a lead role in providing new procurement solutions for London’s public sector Invite people to lead innovation on behalf of a collective client base Align our approach to make procurement simpler, faster and more productive for both clients and suppliers Anticipate multi-layered solutions: Pan London; Sub Regional, Local Clusters (LCP co-ordinated)
  • 148.
    LCP Strategy (cont’d) •LCP’s strategic aim is for London’s public sector authorities and buying organisations to work collectively to achieve higher benchmarks using their respective strengths and combined resources, minimising duplication of effort and maximising value for money.
  • 149.
    LCP Strategy (cont’d) •LCP’s strategy is to: • make available a suite of pan-London constructionrelated Framework Agreements • establish a range of shared services and resources for class-leading procurement and performance management. • enable access to expert knowledge and experience within LCP participating organisations.
  • 150.
    LCP Framework pipeline Thefollowing are some of the frameworks agreements intended to commence procurement by LCP partners over the next year. 1. Minor Contractors 2. Main Contractors Up to £100,000 £100,000 to £1m Local level LCP Nov 2014 5. Main Contractors 4. Mechanical 3 . Main Contractors £1m to £5m LCP Nov 2014 4. Main Contractors 6. Landscaping Contractors £5m to £10m + LCP Nov 2014 £5m - £10m Contractors 5. Electrical Contractors Over £10m LCP Oct 2014 LCP Oct 2014 LCP Oct 2014 8. Conservation Architects 9. Timber Windows and Doors 10. Volumetric (housing) structures GLA/tbc LHC Jan 2014 LHC tbc Southern Region April 2015 7. Adaptations to Housing properties for less able LCP Dec 2014 High priority items are 1-16, and 22 -25. All Items please refer to Haringey, except Item 9-15 and 22 LHC and items 16, 23-25 CCS February 2013
  • 151.
    LCP Framework pipeline Pleaserefer for latest updates and further details to the pipeline on the website http://lcp.g2b.info/frameworks/ LHC 2015 13. Asbestos Surveyors 14. Asbestos Contractors 15. Building Insulation LHC 2015 11. Gas Servicing 12. Communal entrance doors and door entry systems LHC Feb 2014 LHC Feb 2014 LHC 2015 19. Demolitions 20. CCTV tbc tbc 24. Building Materials 25. Project Management and Full Design 16. Commercial Catering & Refrigeration 17. Lift installations & maintenance CCS Nov 2014 tbc 21. Conservation Works 22. New Build Extensions and General Refurbishment Works for Schools and other community buildings tbc LHC - Expires 30th June 2017 18. Stairlifts installation, servicing and maintenance (Fusion 21) 23. Estates Professionals CCS - Expires 31st March 2017 CCS April 2014 N.B. Please note this is only an indication of intended frameworks. These may or may not be put in place. February 2013 CCS April 2014
  • 152.
    LCP Framework pipeline Pleaserefer for latest updates and further details to the pipeline on the website http://lcp.g2b.info/frameworks/ Consultants Main Contractors CRCS2012 IESE LCP Expires 29th Feb 2016 Expires April 2015 Architects, Design and Urban Planning GLA Nov 2013 N.B. Please note this is only an indication of intended frameworks. These may or may not be put in place. February 2013
  • 153.
    Authorities position forCRCS 2012 Enfield Barnet Harrow Haringey Brent Hillingdon Waltham Forest Redbridge Havering Camden Tower City Hamlets Ealing Newham Barking & Dagenham Greenwich Hounslow Bexley Richmond Wandsworth Lewisham Merton Kingston Bromley Sutton Signed up Croydon London-wide organisations LFB Metropolitan Police Other mechanisms in place
  • 154.
    LCP Contractors Frameworks • • • • • • • • Tobe EU Compliant. To have easy access to market Collaboration between authorities Pan London – (procurement efficiency) Standardisation of process and contract documentation. KPI’s drawn from National level Link to National Agenda. Be flexible.
  • 155.
    LONDON CLUSTER 100k to £1m <£100k Southern Framework LONDON CLUSTER £1m to £5m LONDON CLUSTER £5m to £10m + LOCAL Minor Works LCP Major Works > £10m USE IESE UNTIL 2015 LCP Contractor Frameworks Turnover values and number of contractor in each value band to be agreed
  • 156.
    LCP Contractors Frameworks •Aggregation of effort, resource and spend • Standardise procurement, design and delivery • Common specifications where possible • Share best practice • Achieve efficiencies
  • 157.
    Overview - Contractors/Specialist contractors • Developing various Frameworks • Major contractors • Specialist – – – – Mechanical Electrical Landscaping Housing adaptations for the less able
  • 158.
    Overview • The listof Public Bodies that may use the Contractors Frameworks will be referred to through the advert and the Memorandum of information. • Standard OJEU has been developed for adverts. • The Framework Agreement will be open predominantly to Local Authorities within London • Could include Police Authorities and Fire Authorities, and Primary Care Trusts associated with the Local Authorities. • Any faith educational establishments, associated with the named Local Authorities.
  • 159.
    Overview (cont’d) All registeredSocial Landlords (as defined in Part 1 of the Housing Act 1996) and their agents within the geographical area of London includes all ALMO’s or any successor body of the 33 Local Authorities within London. It will also include any bodies previously covered by these Authorities such as “free schools” and academies, further education, and any Trusts, Social Enterprises, Mutuals, and Community Interest Companies that are within the 33 Local Authorities within London and the contracting Authorities are trustees or partners of the Social Enterprises, Mutuals and Community Interest Companies or any similar organisation formed within the community. Other Public Sector Organisations.
  • 160.
    Overview – MajorWorks The types of projects anticipated in this framework include, but are not limited to: •new build construction works; •planned maintenance either capital and revenue projects; •adaptations; •refurbishments; •improvements •regeneration works; •extensions etc Could be defined lots for Housing (S20’s) and Education etc.
  • 161.
    Overview - Specialists •The types of projects anticipated in the framework include, but are not limited to: • planned maintenance either capital and revenue projects; • some reactive • Boiler replacements etc • Electrical Rewiring
  • 162.
    Overview - Specialists •The types of projects anticipated in the framework include, but are not limited to: • Hard and soft Landscaping • Playgrounds/MUGAs etc • Housing adaptations for less able to public and private sector associated with Disabled Facility Grants etc
  • 163.
    How? • Clusters approachi.e. East, North, West, South West, South East, • Note:- certain areas have own frameworks to join later in life of Frameworks • Contractors will need to apply for each area.
  • 164.
    How (cont’d) -London Regions North West East Enfield Barnet Harrow Haringey Brent Hillingdon Waltham Forest Redbridge Camden Barking & Dagenham Tower City Hamlets Ealing Newham Greenwich Hounslow Bexley Richmond Wandsworth Havering South East Lewisham Merton Kingston South West Bromley Sutton Croydon London-wide organisations LFB Metropolitan Police Proposed London Regions (to be confirmed)
  • 165.
    How – benefits? • • • • • Tobe created by London Authorities for London Authorities Collaborative working Centralised monitoring of the framework agreement Templates available for appointment etc Standardisation of policies – Apprentices etc, local labour, Timber policy • Key Performance Indicators • Different forms of contract can be used – JCT suite, PPC 2000 etc, NEC3 • Flexibility of Procurement routes, Two stage D and B, D and B, trad etc
  • 166.
    How – Benefits? • • • • • • Pointsof contact for help for Local Authorities Standard approaches Regular performance reviews with the Contractors Key objectives to be defined Work across a variety of sectors Projects of varied types can be procured through the framework • Information packs for contractors
  • 167.
    How – stages? •Stage 1 • Scoping - Questionnaires with Clients • Stage 2 • Soft Market testing with contractors
  • 168.
    How - stages? Stage3 • PQQ- to be defined using constructionline and PAS 91 where possible same for all lots (variances for values and types of work) Stage 4 • Full EU advert
  • 169.
    Programme – MajorWorks • Soft Market – May/June 2013. • Advert - February 2014 • Tender – May/June 2014 • Mid Tender reviews – webinars – May 2014 • Award December 2014/January 2015 for four years • NB – Allow for section 20 process (Haringey and others) •
  • 170.
    In summary • LCPis comprised of organisations that want to collaborate & achieve efficiencies • LCP frameworks will be supported by the lead authority • LCP is open to all public sector organisations in London • Major works and specialists contractors frameworks
  • 171.
    Further Information Website : http://lcp.g2b.info Websiteincludes pipeline of LCP frameworks that maybe procured with partners. Frameworks that can be currently accessed.
  • 172.
  • 173.
  • 174.
    Sourcing Suppliers –Supporting the SME Constructionline “Meet the Buyer” Event Terry Brewer, Divisional Director, Commercial, Contracts & Procurement, Harrow Council and Chair of London Heads of Procurement Network.
  • 175.
    Agenda • Procurement driversand trends • National picture – CCS and Local Government • FSB survey • Construction related issues • What we are doing for SMEs
  • 176.
    Procurement Drivers • Reducingbudgets – ‘graph of doom’ • Need to maintain statutory services • Desire to generate “social value” from public procurement – Including government objective to create opportunities for small businesses – and even when not legally required by the Public Services (Social Value) Act 2012
  • 177.
    Procurement Trends • Betterresource efficiency – in terms of money, energy, materials, time etc • E-everything – Procurement, contract management, communication • Decentralisation – e.g. Schools becoming independent Academies • Local authorities working together, more – including use of national and regional frameworks and systems such as Constructionline
  • 178.
    National position: Changesto EU legislation • Revised EU regulations will make it faster, easier and cheaper for small firms to bid • Changes include: – Not needing to provide extensive supporting evidence – only successful bidder will need to do so – Not needing to provide 3 years accounts – will only need revenue to be twice value of deal – Clarification re breaking down requirements into ‘Lots’ • Timetable – EU adoption expected this month – Govt seeking to tranpose within 7 months
  • 179.
    National Position –what is CCS doing? Introduced the Crown Representative for SMEs – they have a voice at the top table Developing tools to make it easier to find opportunities to do business with Government – Contracts Finder, Solutions Exchange Reformed the procurement process ‘removing barriers’ – abolished PQQ below threshold, LEAN SMEs given new channels of communication including Mystery Shopper and SME Panel Lead ministers and SME Champions appointed. Departmental SME plans with specific targets for spend with SMEs Big is not always beautiful – Optimal contract size Optimise lotting structure Getting the best bidders bidding
  • 180.
    What is theLGA doing? • LGA is taking a category management approach to the spend nationally in local government • 3 categories being supported in first wave – ICT, Energy and Construction • Aim is to have a National Category Strategy for each area • Part of each category strategy is to set out key issues for SMEs and how that market should be approached on a national/regional and local basis
  • 181.
    What does theFSB survey say? • FSB 2013 survey – around half of Boroughs responded • On average boroughs in London spend 35% of their total procurement expenditure on SMEs (up from 27%) • 50% of boroughs seek to pay suppliers within 28 days (up from 37%) • 36% of boroughs seek to pass on their payment terms to main contractors • Conclusions of survey – need to do more spend analysis, simplify processes, and more pre-engagement activities
  • 182.
  • 183.
    Likely construction opportunities •Design and build of new [social] housing • Integration of “green” technologies into built environment and improving its energy efficiency • Expansion to and new build of schools because of “pupil bulge” • Aids and adaptations to homes of elderly and disabled people
  • 184.
    What we needfrom the construction marketplace • • • • • • • • Quality Efficiency – reflected in pricing Getting it ‘right first time’ Innovative solutions Competition for our contracts A partnership approach Honest feedback Jobs, apprenticeships and training for our communities • Improved environmental performance
  • 185.
    What we aredoing for SMEs • Reducing down pre-qualification criteria & questions – And encouraging all procurers to ask similar, simplified questions eg PAS91 adoption – And finding ways to avoid asking you for the same information, in relation to more than one procurement, in a short space of time eg SSIP model for Health & Safety • Using “SME friendly” pre-qual systems and portals – E.g. Constructionline, London Tenders Portal, Compete For • Creating opportunities for SMEs as 2nd and 3rd tier suppliers on large projects, through ITT questions and contract clauses • Getting ready to adopt new “SME friendly” public procurement directives
  • 186.
    Free opportunities tobuild your capacity and capability • CITB “Sustainable Supply Chain School” – www.supplychainschool.co.uk • CITB “Be Fair” Framework, guidance and toolbox talks – http://www.citb.co.uk/employer-support/fairness-inclusionand-respect/ • Coming soon; CITB “Shared Apprenticeship Scheme” – so that you can employ an apprentice (via the CITB) to work on a specific package whenever you have the need/ opportunity – http://www.citb.co.uk/citb-apprenticeships/sharedapprenticeship-scheme/ • Council “Selling to the Council” web pages e.g. www.harrow.gov.uk
  • 187.

Editor's Notes

  • #5 http://www.flickr.com/photos/selcukaral/2135428597/http://www.flickr.com/photos/eugene/51380973/sizes/l/
  • #6 http://www.flickr.com/photos/friend_faraway/1589070517/sizes/o/
  • #7 http://www.flickr.com/photos/atwatervillage/842866223/sizes/l/
  • #8 http://www.flickr.com/photos/davipt/299545533/sizes/l/
  • #9 http://www.flickr.com/photos/mollyeh11/126883869/sizes/l/
  • #10 http://www.flickr.com/photos/dnorman/251646154/sizes/l/
  • #124 Key characteristicsNot mandatory – voluntaryCarrot not stickSupplier drivenBased on trustFree at the point of use: lots of free resourceIts confidential to each supplier Evaluation ToolLevels – all variable by system administratorSub-con or supplierProcurement categoryProduct\service descriptionSustainability Impacts x 10 – all variable by system administratorHeat Mapped ratings of these impacts – as defined by contractorSupplier logs on and picks supply category(s)System ONLY selects the questions that are rated as “red or amber” for those categoriesResource PortalLinks to web resourceCase studiesRecommend participation in schemesEvents and workshopsFormal trainingExpert help
  • #133 What are the Benefits of the School?The business benefits to suppliersGrowth opportunities for suppliers – access emerging marketsConsolidate position in existing marketsFuture proof themselves against coming legislative requirementsMeet client demandsMore resilientThe sustainability benefits Measurable improvements to social and environmental sustainability impactsBenefits to contractors An increased pool of sustainable suppliersMeet client demand, access markets
  • #140 This month, the LEP is 1 year old and growing in strength and influence.
  • #146 The Coalition Government scrapped the BSF programme and has slashed the Decent Homes programmeWe need to be ever more creative and look for new and more efficient ways to deliver our Capital programmes
  • #147 We have achieved consensus with many organisations on a standard OJEU notice for future Pan London procurement.We work with advisory panels to develop procurement strategy and to design frameworks pre-tender.
