ca Intellicenter
MS Project Integration: Tips,
Tricks and What's New for You
Mindy Calderon
Senior Instructor, North America
CA Technologies
ICX17E #CAWorld
Abstract
 Have you scheduled in Microsoft Project (MSP) and are now presented with the "Tasks" to
maintain a schedule in CA Clarity? Is your organization using CA Clarity but still wants to
schedule in MS Project? Have you noticed that the logic in how CA Clarity schedules is different
in MS Project? And most importantly - wouldn't it be awesome to be able to explain why CA
Clarity and MS Project behave differently but ultimately get you the same result? The session
will show you where and how MSP and CA Clarity bi-directionally map data, how to create and
manage tasks, assignments and scheduling, as well as updating task status and work. It
includes a broad discussion where and when data should be entered in Clarity and MS Project,
on defining data elements and how to capture them.
Mindy
Calderon
CA Technologies
Senior Instructor
2 © 2014 CA. ALL RIGHTS RESERVED.
Agenda
INTEGRATION OVERVIEW
CUSTOM VIEWS
WORK BREAKDOWN STRUCTURE
RESOURCES AND MS PROJECT
Q & A
3 © 2014 CA. ALL RIGHTS RESERVED.
Summary
A Few Words to Describe MS Project Integration with Clarity
Results
MS Project and CA Clarity PPM bi-directionally maps data, manages tasks, assignments and scheduling as
well as updating task status. The Clarity project acts as the ‘umbrella’ for PM methodology . The result is a
project that follows Project Management and Scheduling standards.
4 © 2014 CA. ALL RIGHTS RESERVED.
Definitions
INTEGRATION – BIDIRECTIONAL DATA FLOW USING NEW XML DRIVER
METHODOLOGY – CONSISTENT AND REPEATABLE SCHEDULING AND MANAGING PROCESSES
*
*
This is NOT a Technical Session: Understand from a Functional Perspective
5 © 2014 CA. ALL RIGHTS RESERVED.
Integration Overview

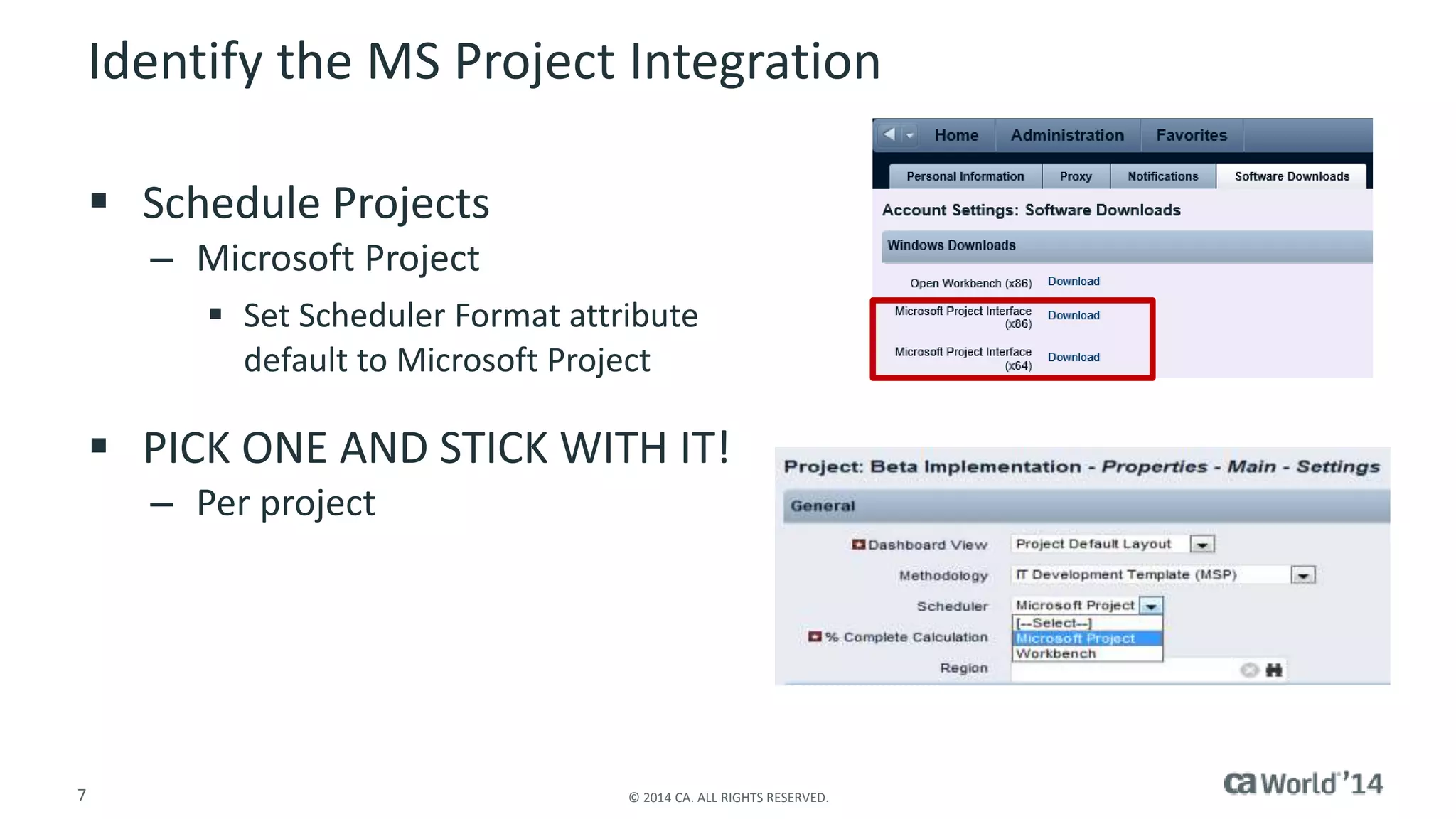

Identify the MS Project Integration
 Schedule Projects
– Microsoft Project
 Set Scheduler Format attribute
default to Microsoft Project
 PICK ONE AND STICK WITH IT!
– Per project
7 © 2014 CA. ALL RIGHTS RESERVED.

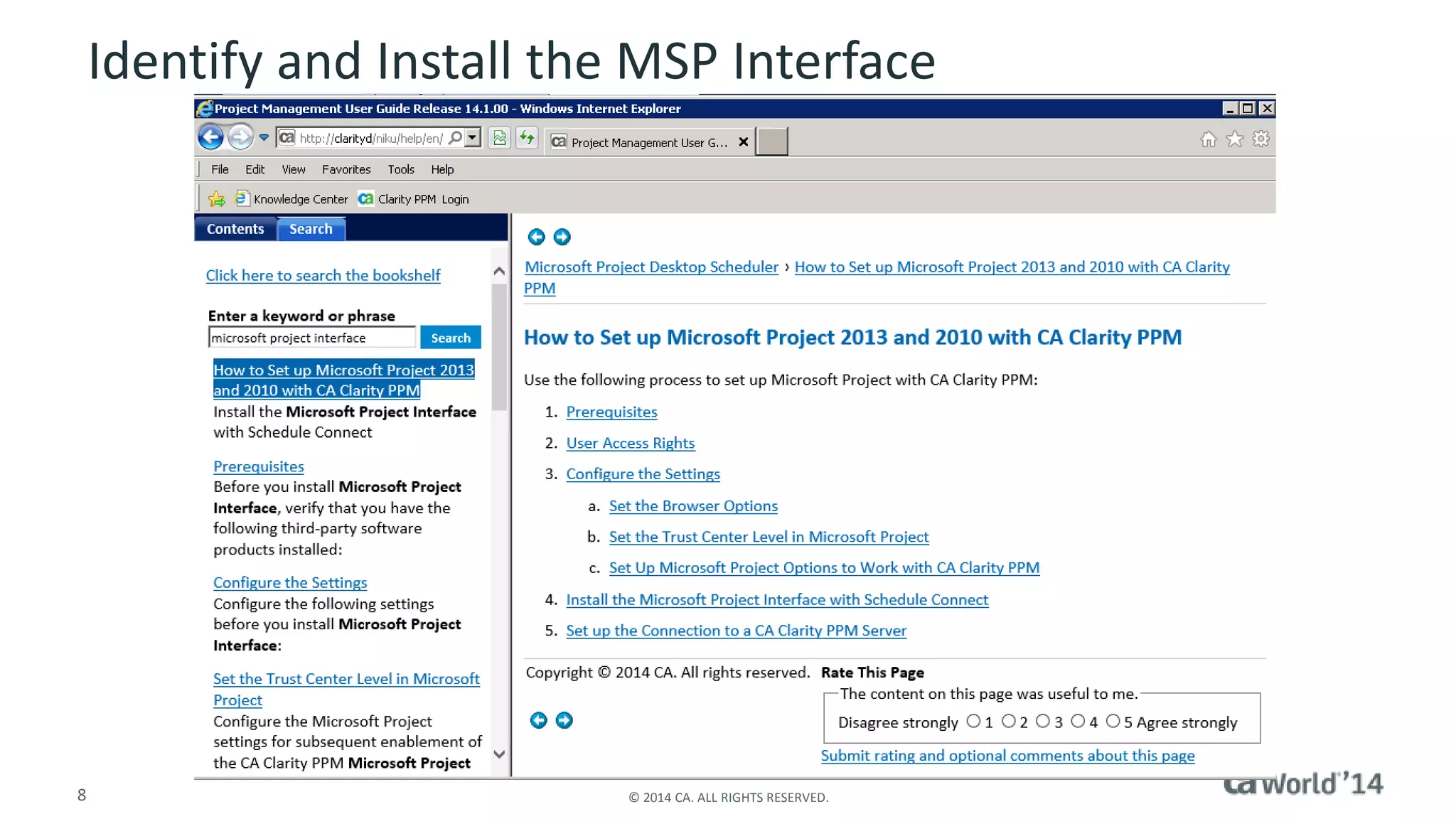

Identify and Install the MSP Interface
8 © 2014 CA. ALL RIGHTS RESERVED.

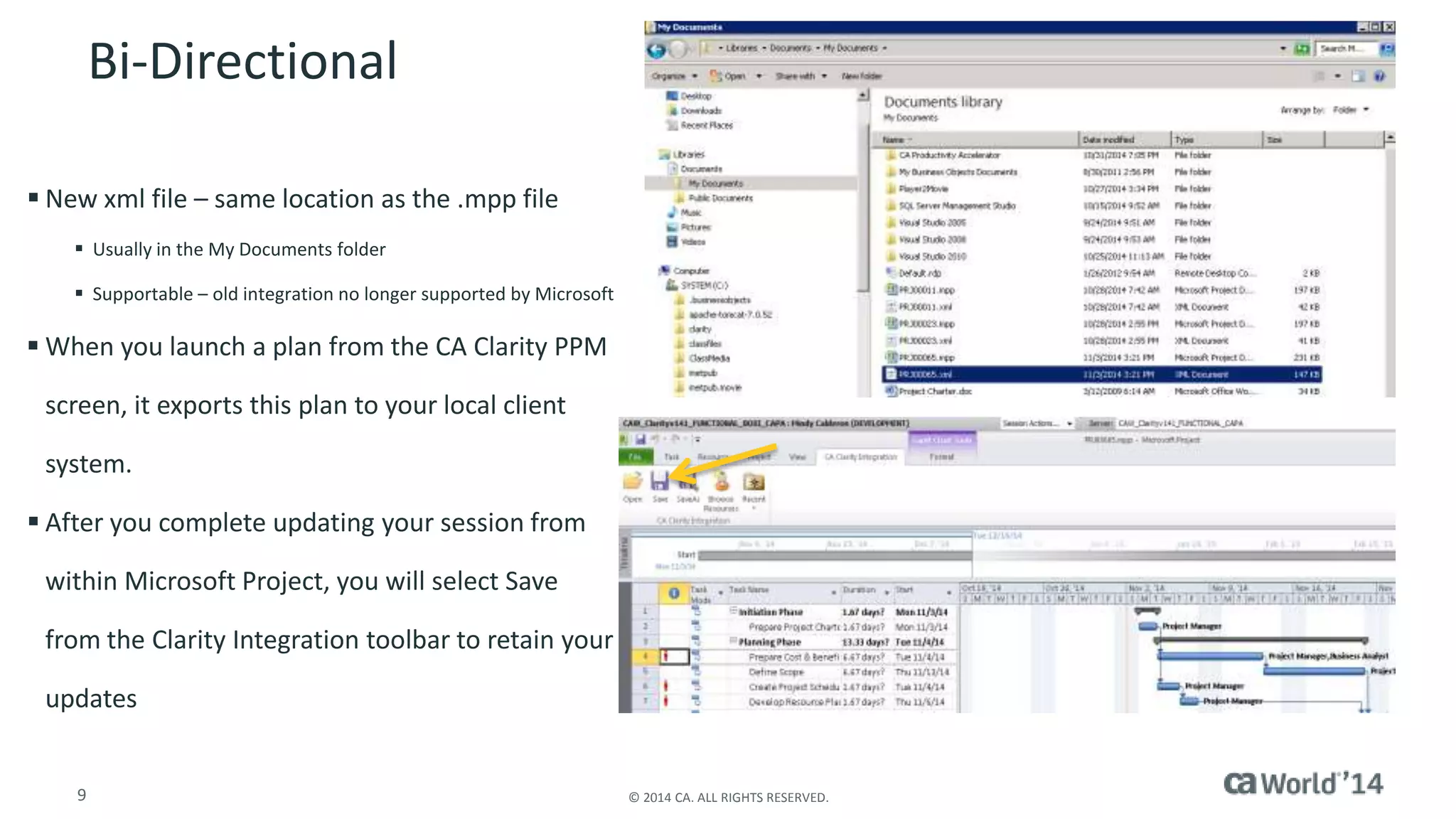

Bi-Directional
 New xml file – same location as the .mpp file
 Usually in the My Documents folder
 Supportable – old integration no longer supported by Microsoft
 When you launch a plan from the CA Clarity PPM
screen, it exports this plan to your local client
system.
 After you complete updating your session from
within Microsoft Project, you will select Save
from the Clarity Integration toolbar to retain your
updates
9 © 2014 CA. ALL RIGHTS RESERVED.

Install the MSP Interface Tips
10 © 2014 CA. ALL RIGHTS RESERVED.

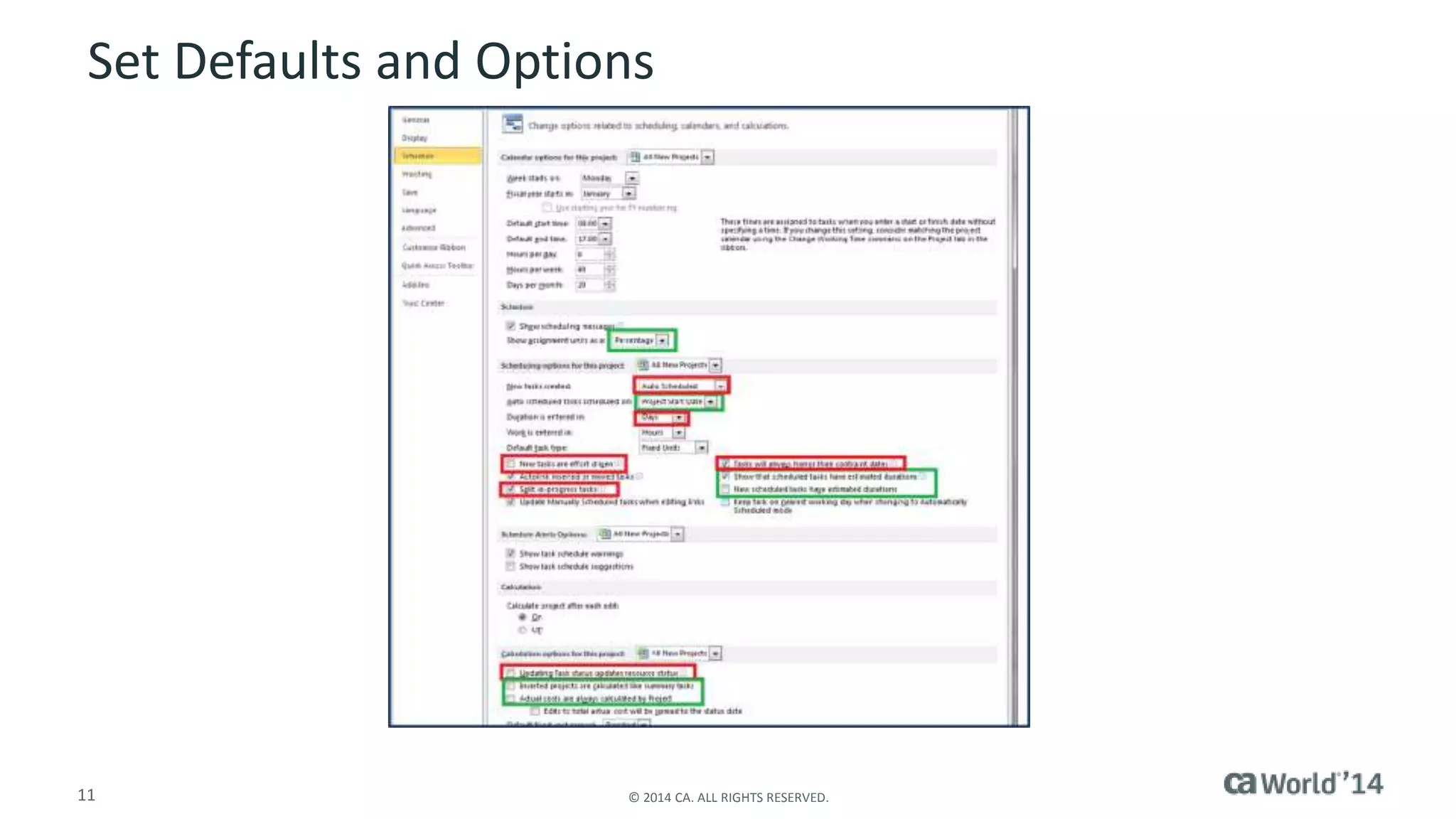

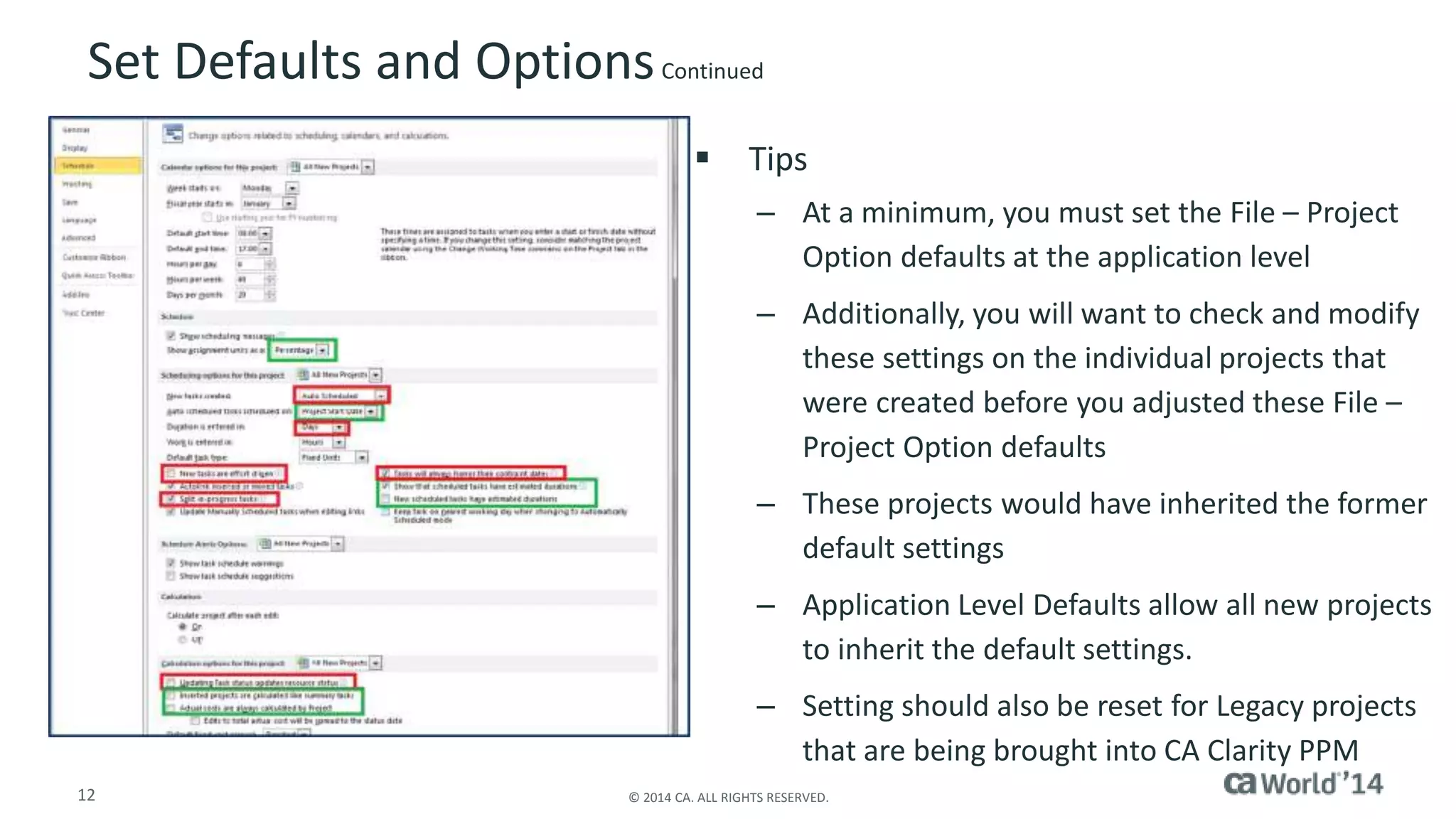

Set Defaults and Options
11 © 2014 CA. ALL RIGHTS RESERVED.
Set Defaults and Options Continued
 Tips
– At a minimum, you must set the File – Project
Option defaults at the application level
– Additionally, you will want to check and modify
these settings on the individual projects that
were created before you adjusted these File –
Project Option defaults
– These projects would have inherited the former
default settings
– Application Level Defaults allow all new projects
to inherit the default settings.
– Setting should also be reset for Legacy projects
that are being brought into CA Clarity PPM
12 © 2014 CA. ALL RIGHTS RESERVED.

Identify Field Mappings
13 © 2014 CA. ALL RIGHTS RESERVED.

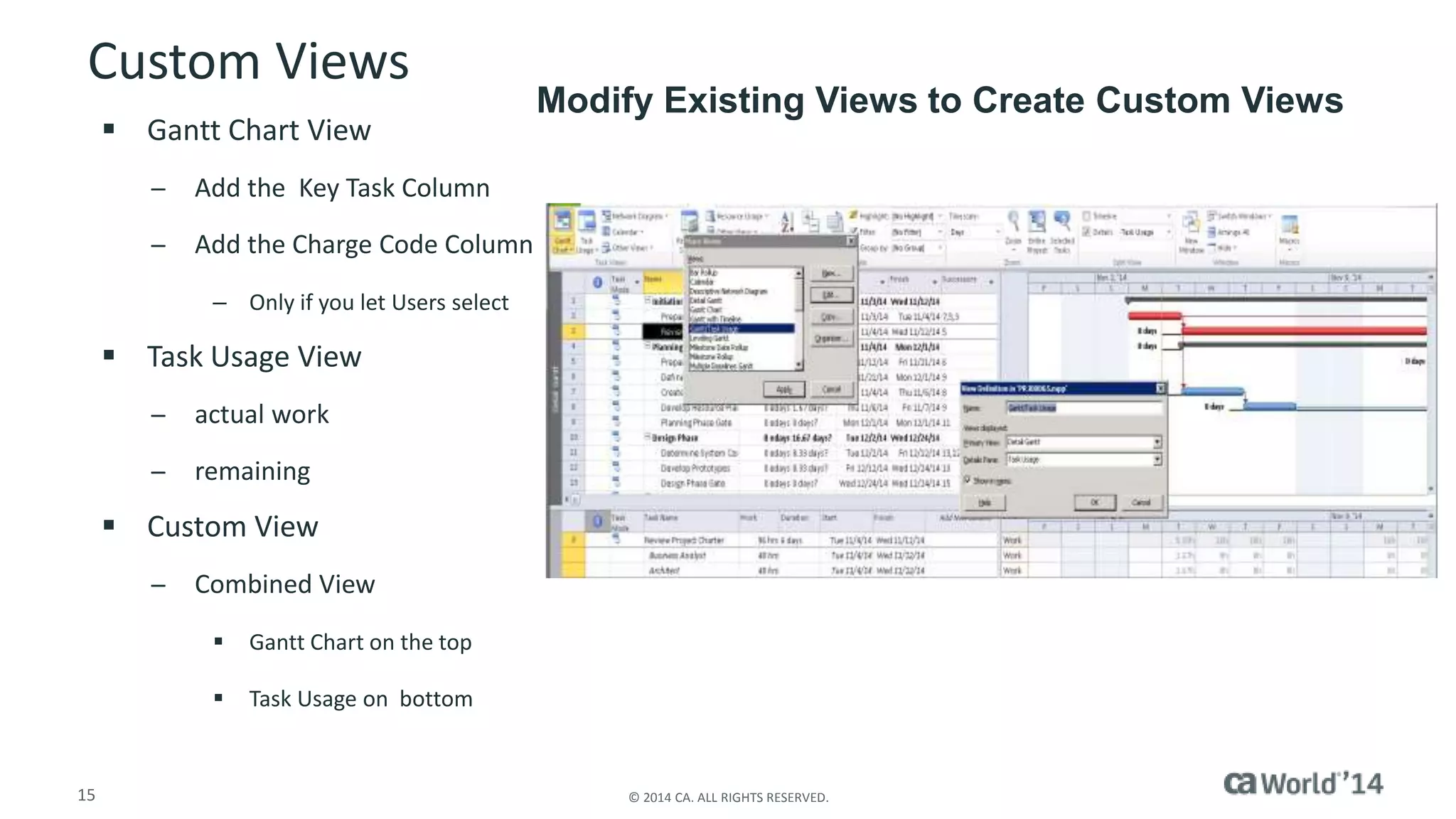

Custom Views and Creating a Project
Custom Views
 Gantt Chart View
̶ Add the Key Task Column
̶ Add the Charge Code Column
– Only if you let Users select
 Task Usage View
̶ actual work
̶ remaining
 Custom View
̶ Combined View
 Gantt Chart on the top
 Task Usage on bottom
Modify Existing Views to Create Custom Views
15 © 2014 CA. ALL RIGHTS RESERVED.

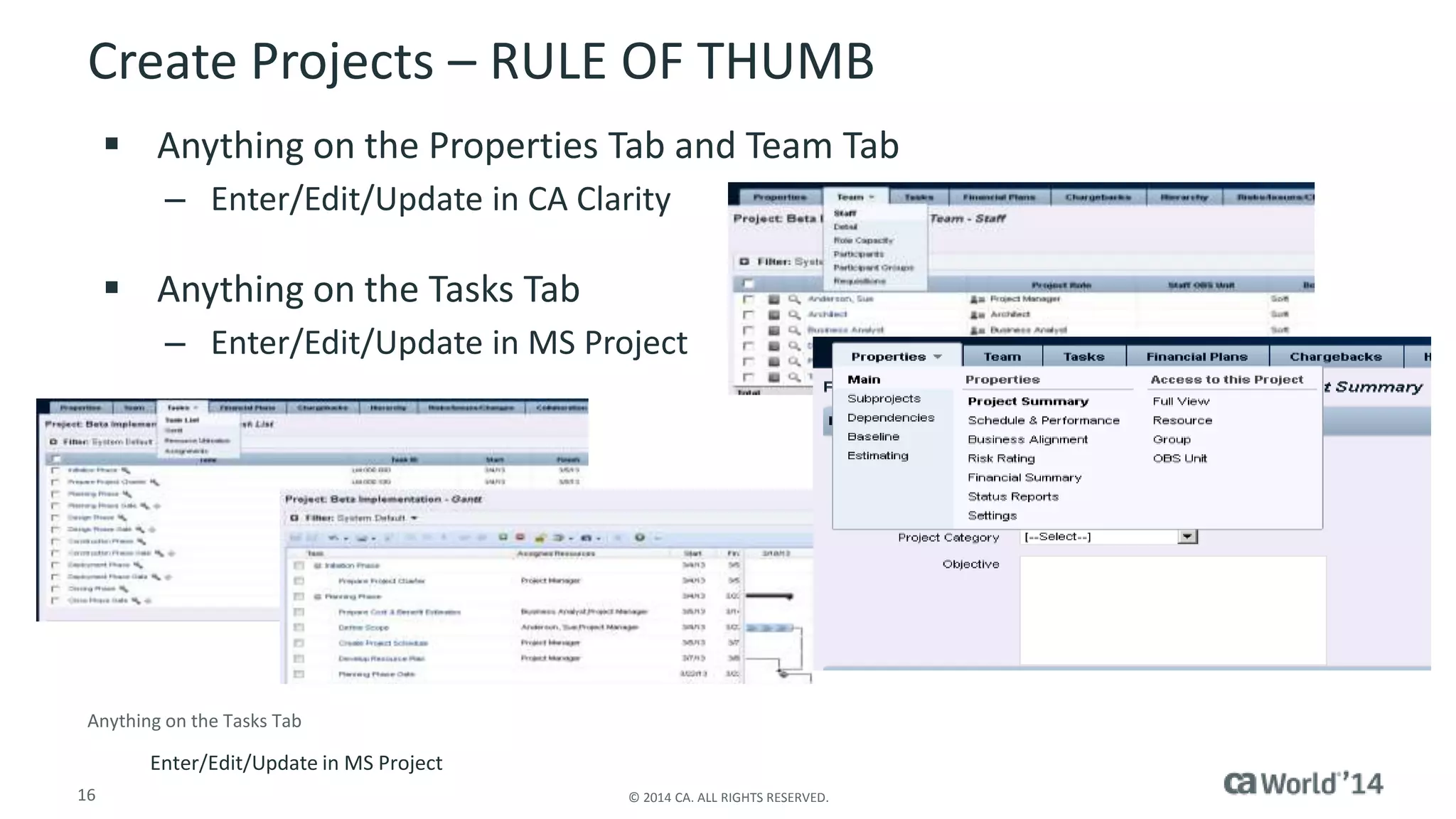

Create Projects – RULE OF THUMB
 Anything on the Properties Tab and Team Tab
– Enter/Edit/Update in CA Clarity
 Anything on the Tasks Tab
– Enter/Edit/Update in MS Project
Anything on the Tasks Tab
Enter/Edit/Update in MS Project
16 © 2014 CA. ALL RIGHTS RESERVED.
Resources and MS Project

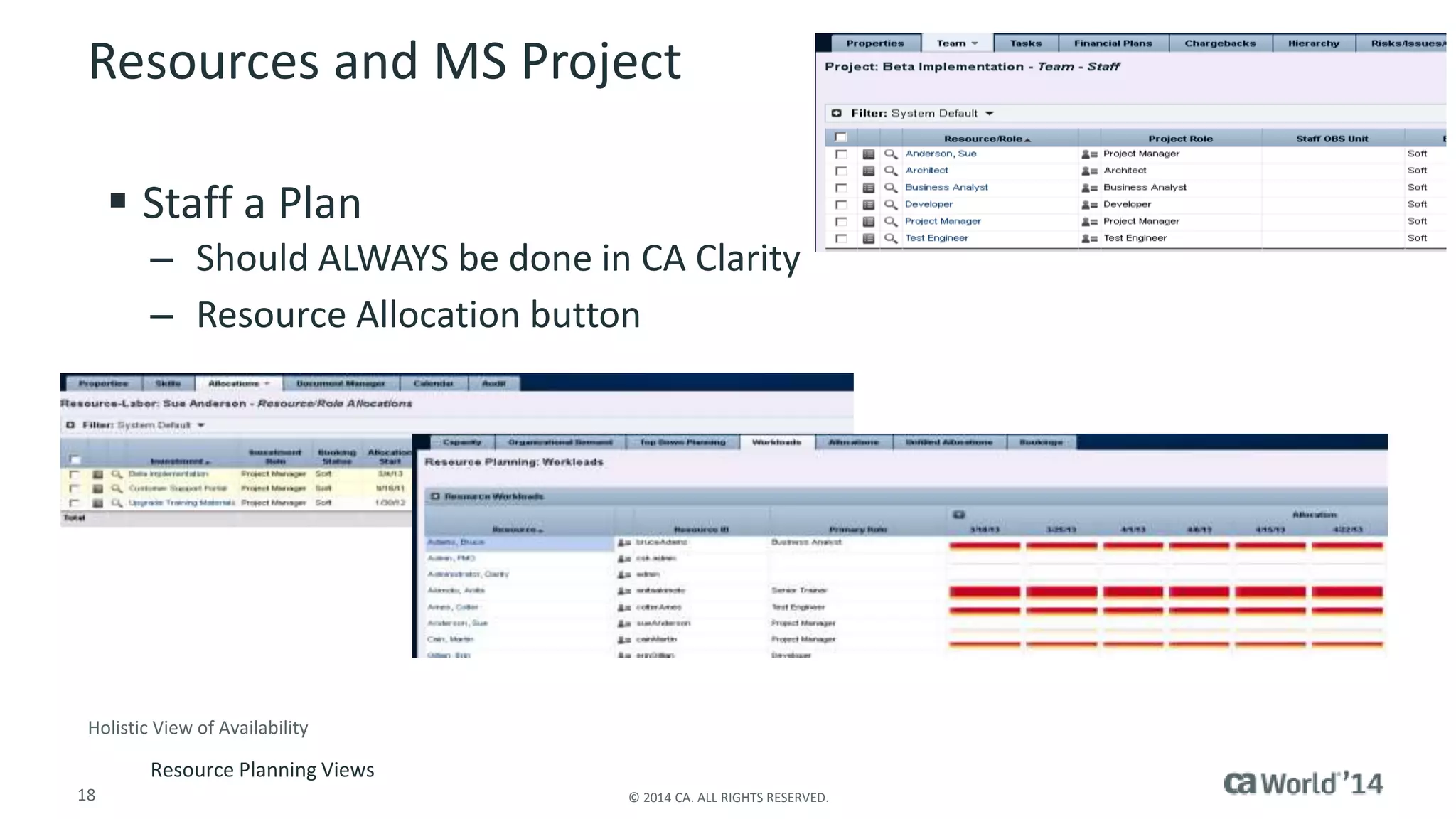

Resources and MS Project
 Staff a Plan
– Should ALWAYS be done in CA Clarity
– Resource Allocation button
Holistic View of Availability
Resource Planning Views
18 © 2014 CA. ALL RIGHTS RESERVED.

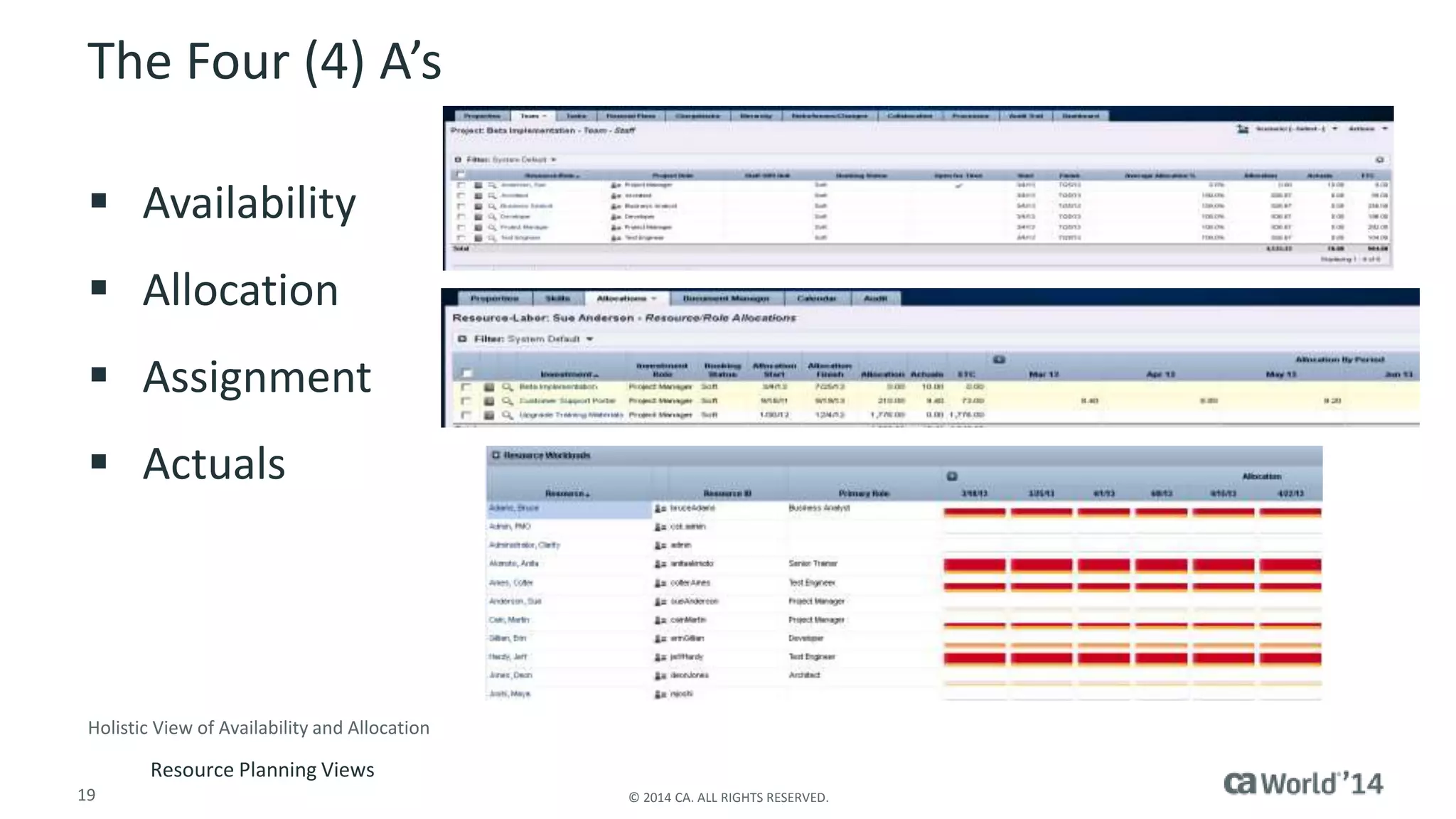

The Four (4) A’s
 Availability
 Allocation
 Assignment
 Actuals
Holistic View of Availability and Allocation
Resource Planning Views
19 © 2014 CA. ALL RIGHTS RESERVED.
Work Breakdown Structure
There are often misunderstandings about the meanings
of the terms “duration” and “work”
A task has duration amount and work amount,
which may not always be equivalent values

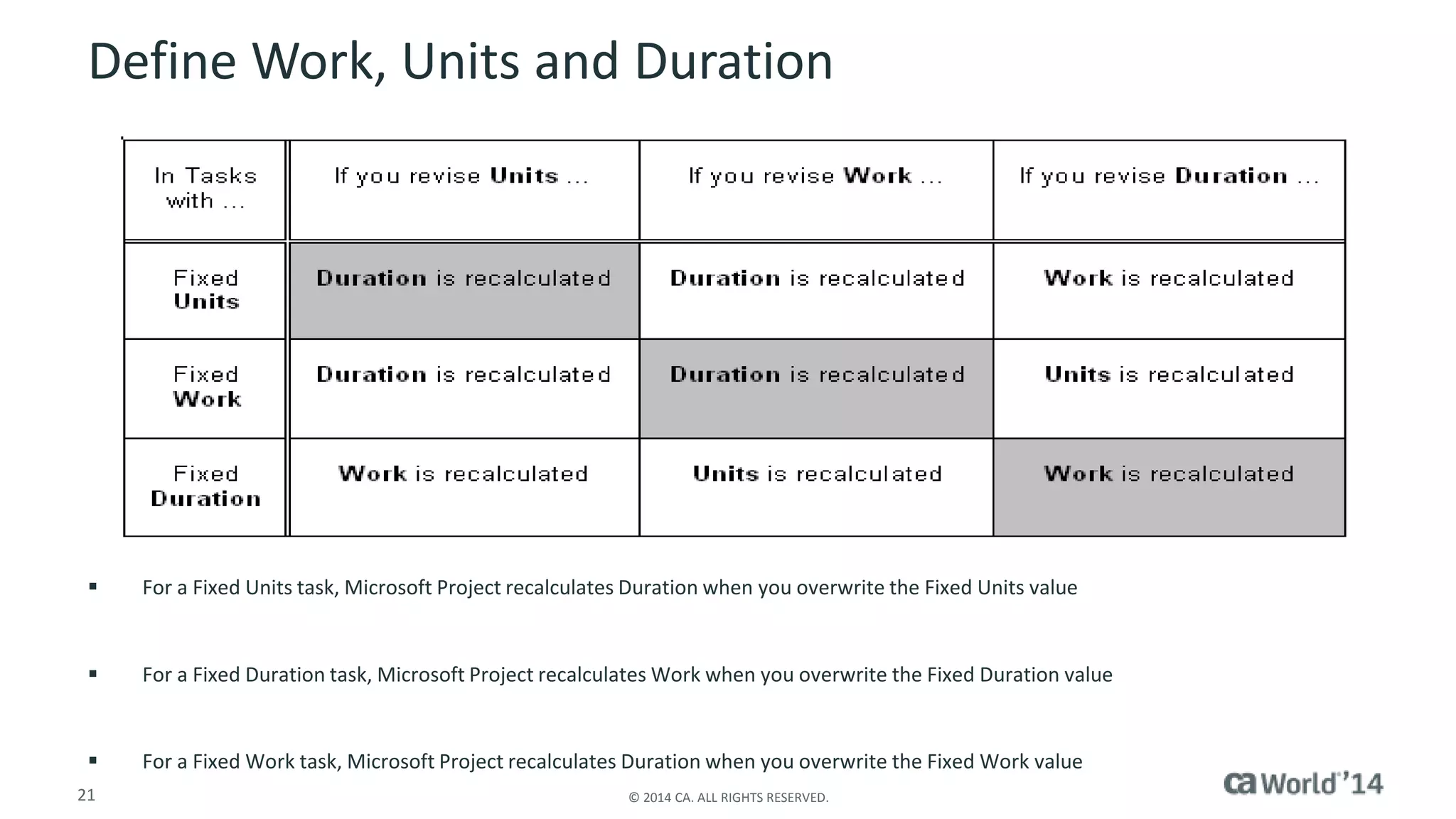

Define Work, Units and Duration
 For a Fixed Units task, Microsoft Project recalculates Duration when you overwrite the Fixed Units value
 For a Fixed Duration task, Microsoft Project recalculates Work when you overwrite the Fixed Duration value
 For a Fixed Work task, Microsoft Project recalculates Duration when you overwrite the Fixed Work value
21 © 2014 CA. ALL RIGHTS RESERVED.
Identify Task Management Guidelines
Terminology Differences Between CA Clarity PPM and Microsoft Project
22 © 2014 CA. ALL RIGHTS RESERVED.

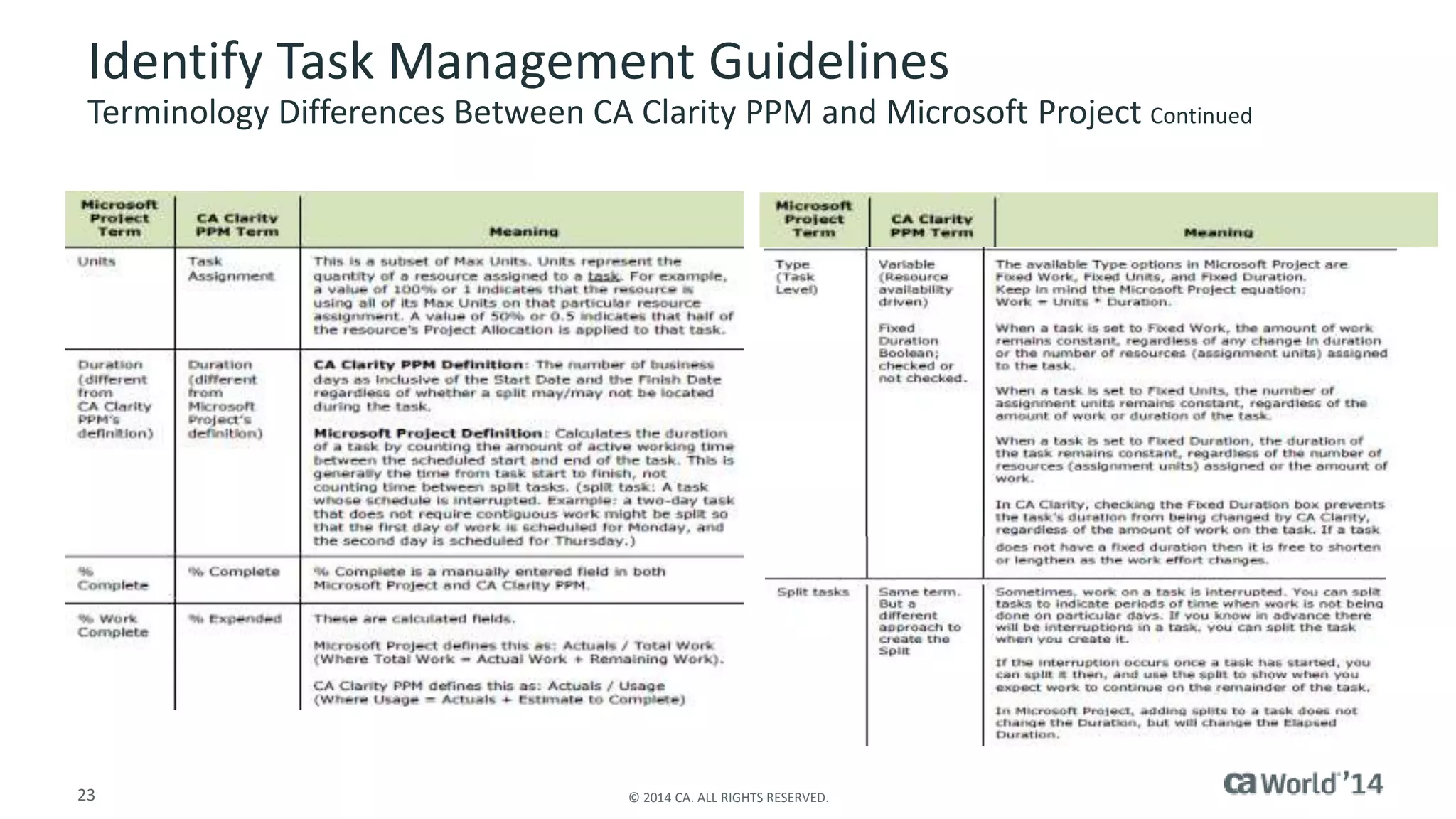

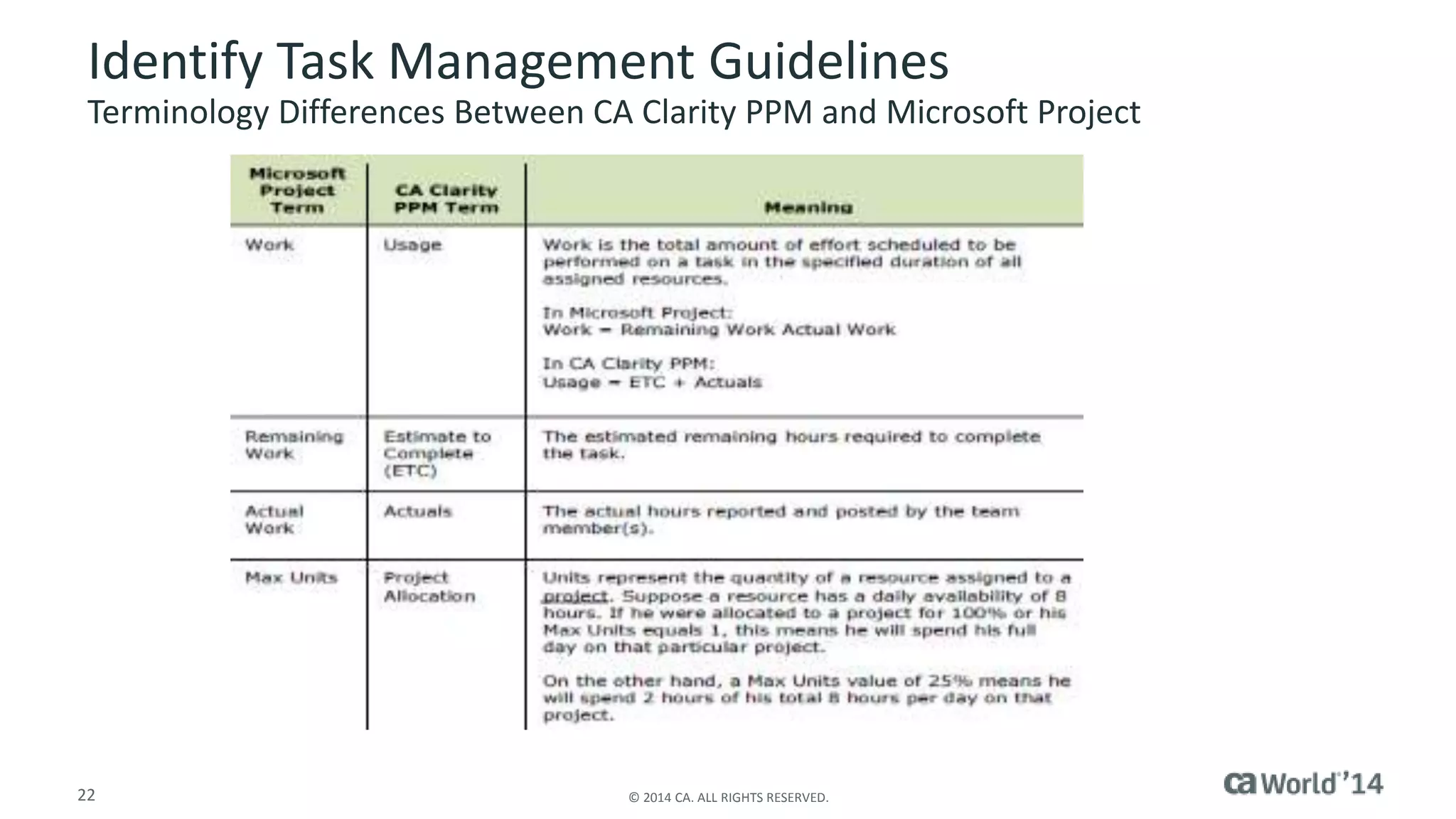

Identify Task Management Guidelines
Terminology Differences Between CA Clarity PPM and Microsoft Project Continued
23 © 2014 CA. ALL RIGHTS RESERVED.

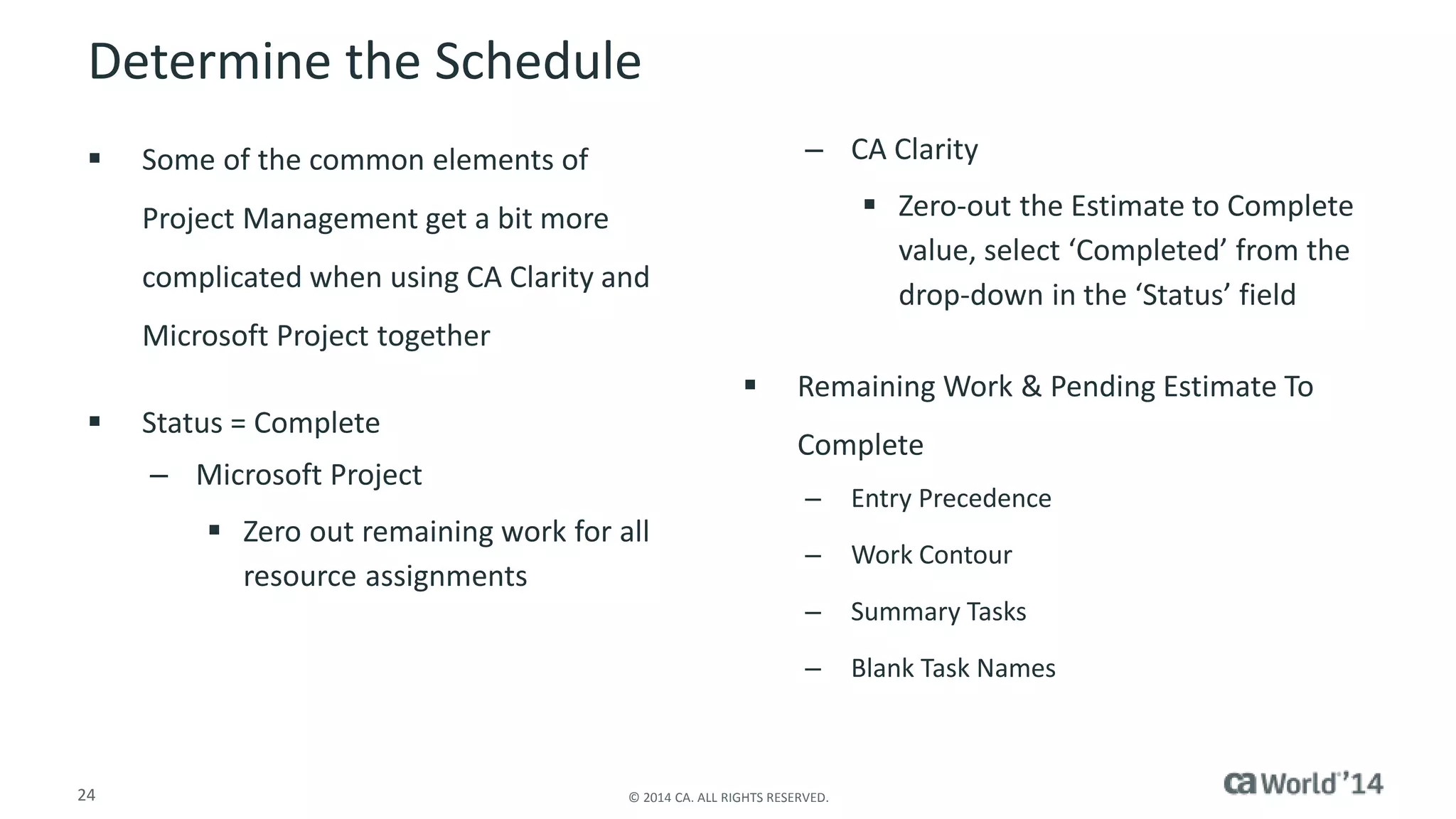

Determine the Schedule
 Some of the common elements of
Project Management get a bit more
complicated when using CA Clarity and
Microsoft Project together
 Status = Complete
– Microsoft Project
 Zero out remaining work for all
resource assignments
– CA Clarity
24 © 2014 CA. ALL RIGHTS RESERVED.
 Zero-out the Estimate to Complete
value, select ‘Completed’ from the
drop-down in the ‘Status’ field
 Remaining Work & Pending Estimate To
Complete
– Entry Precedence
– Work Contour
– Summary Tasks
– Blank Task Names
Control the Project

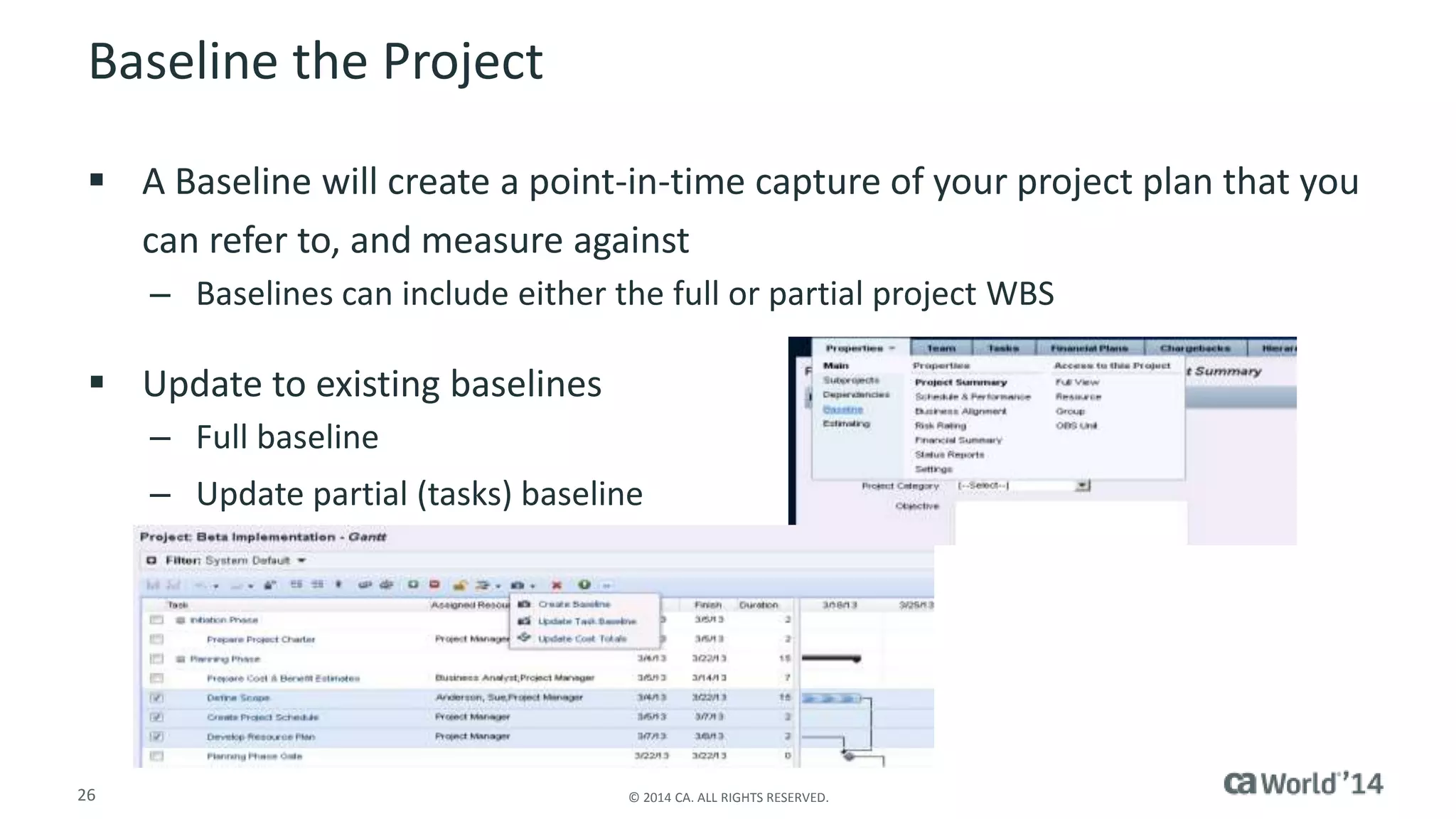

Baseline the Project
 A Baseline will create a point-in-time capture of your project plan that you
can refer to, and measure against
– Baselines can include either the full or partial project WBS
 Update to existing baselines
– Full baseline
– Update partial (tasks) baseline
26 © 2014 CA. ALL RIGHTS RESERVED.

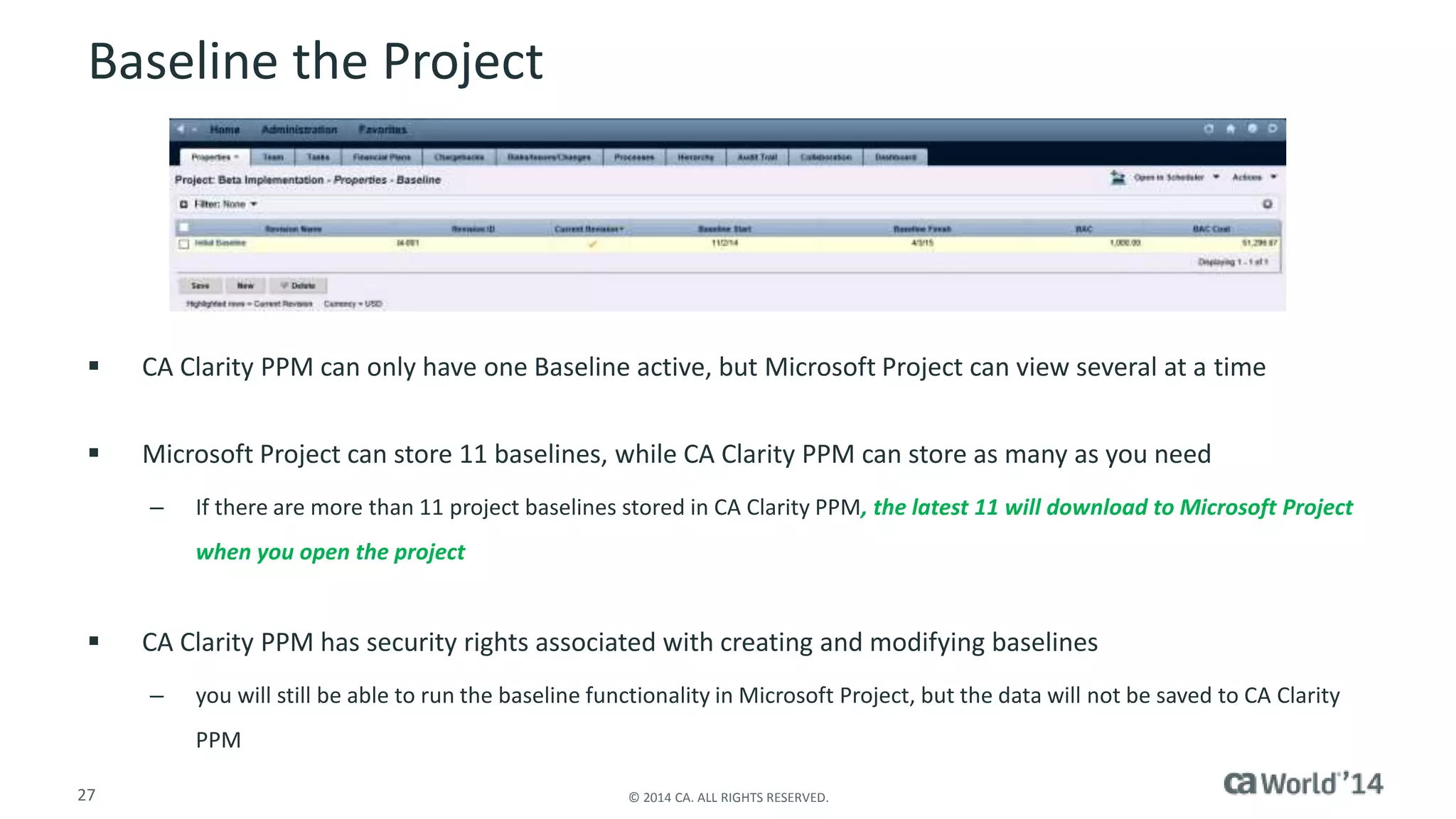

Baseline the Project
 CA Clarity PPM can only have one Baseline active, but Microsoft Project can view several at a time
 Microsoft Project can store 11 baselines, while CA Clarity PPM can store as many as you need
– If there are more than 11 project baselines stored in CA Clarity PPM, the latest 11 will download to Microsoft Project
when you open the project
 CA Clarity PPM has security rights associated with creating and modifying baselines
– you will still be able to run the baseline functionality in Microsoft Project, but the data will not be saved to CA Clarity
PPM
27 © 2014 CA. ALL RIGHTS RESERVED.

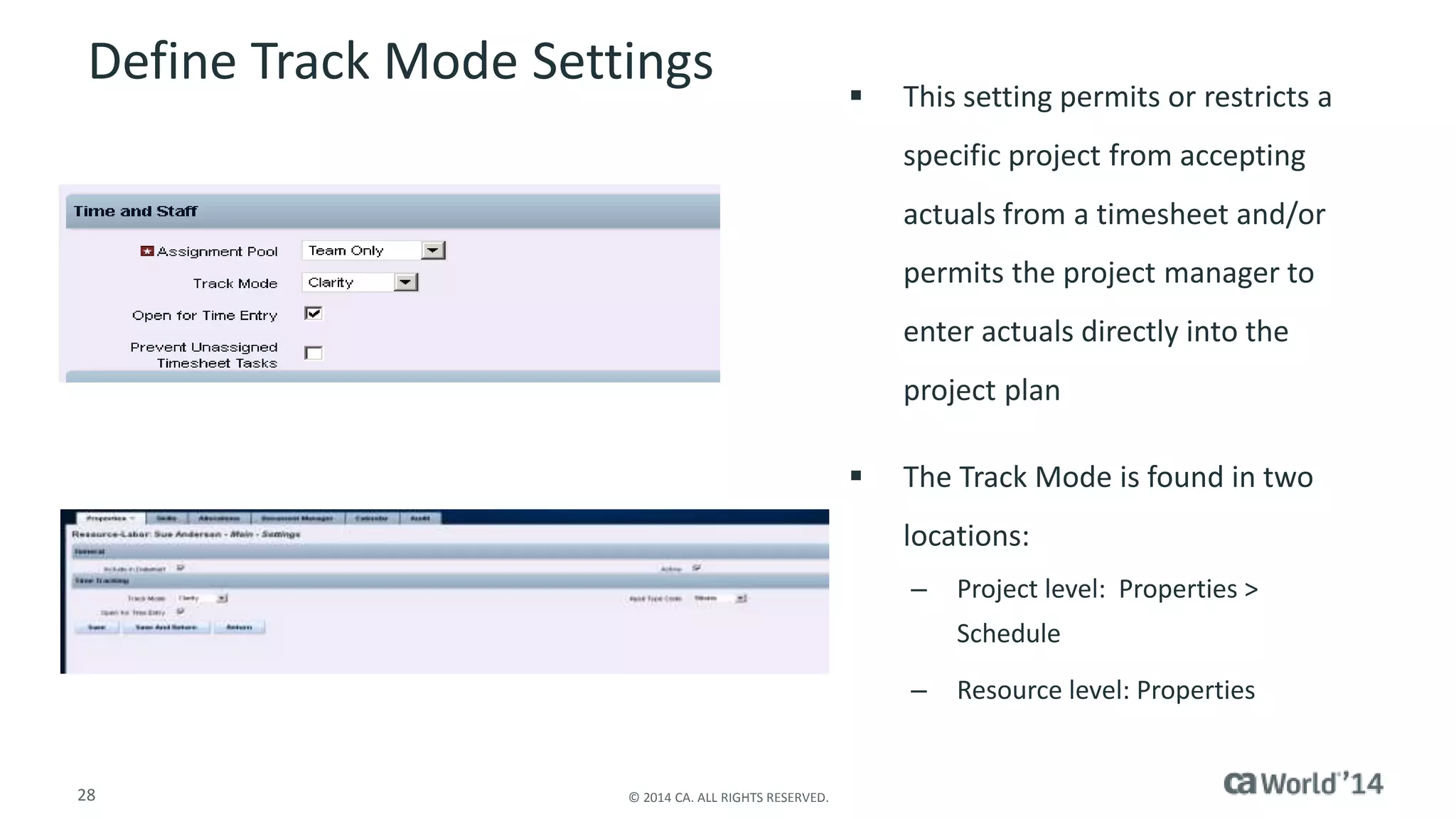

Define Track Mode Settings  This setting permits or restricts a
28 © 2014 CA. ALL RIGHTS RESERVED.
specific project from accepting
actuals from a timesheet and/or
permits the project manager to
enter actuals directly into the
project plan
 The Track Mode is found in two
locations:
– Project level: Properties >
Schedule
– Resource level: Properties

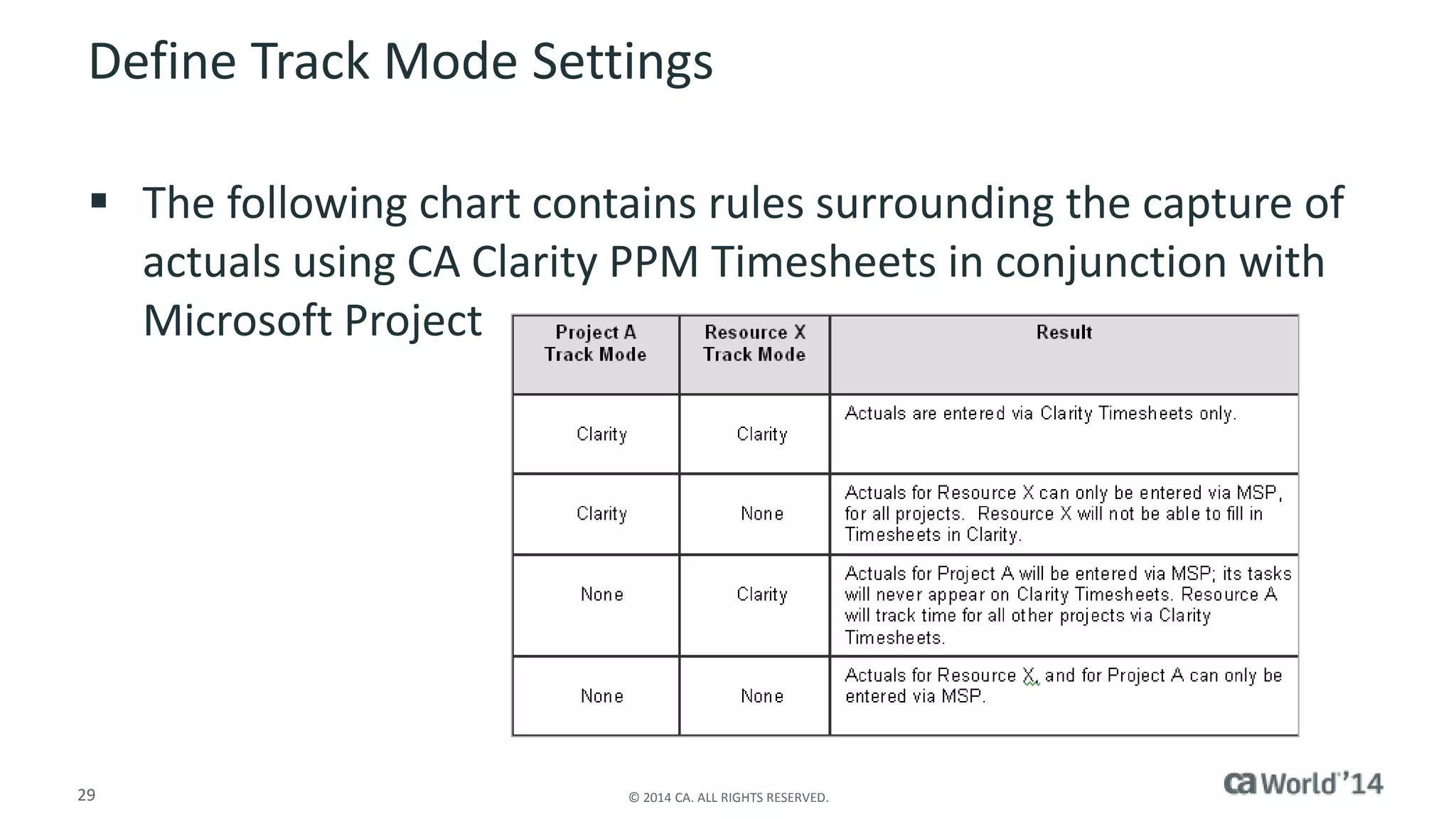

Define Track Mode Settings
 The following chart contains rules surrounding the capture of
actuals using CA Clarity PPM Timesheets in conjunction with
Microsoft Project
29 © 2014 CA. ALL RIGHTS RESERVED.

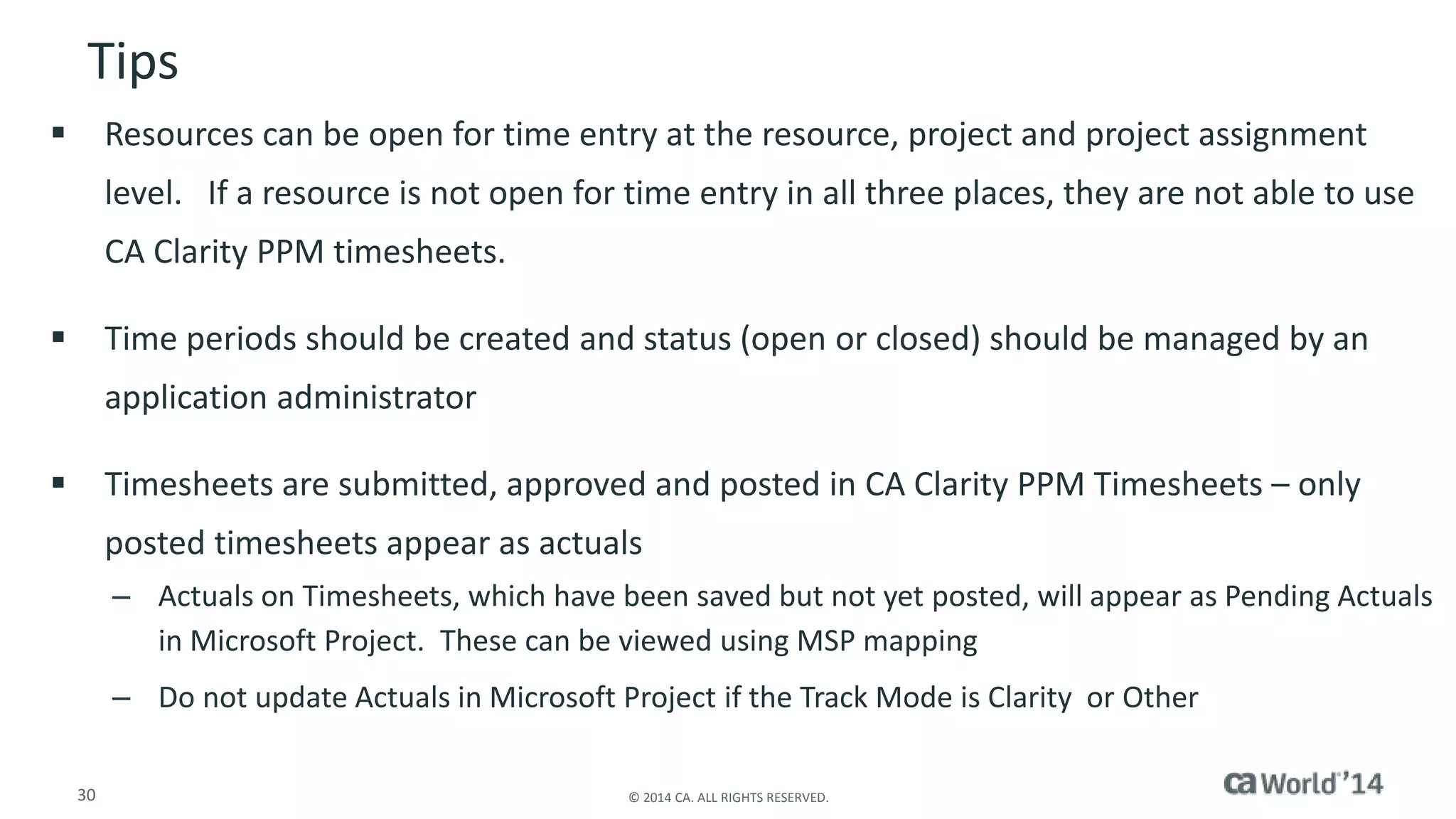

Tips
 Resources can be open for time entry at the resource, project and project assignment
level. If a resource is not open for time entry in all three places, they are not able to use
CA Clarity PPM timesheets.
 Time periods should be created and status (open or closed) should be managed by an
application administrator
 Timesheets are submitted, approved and posted in CA Clarity PPM Timesheets – only
posted timesheets appear as actuals
– Actuals on Timesheets, which have been saved but not yet posted, will appear as Pending Actuals
in Microsoft Project. These can be viewed using MSP mapping
– Do not update Actuals in Microsoft Project if the Track Mode is Clarity or Other
30 © 2014 CA. ALL RIGHTS RESERVED.

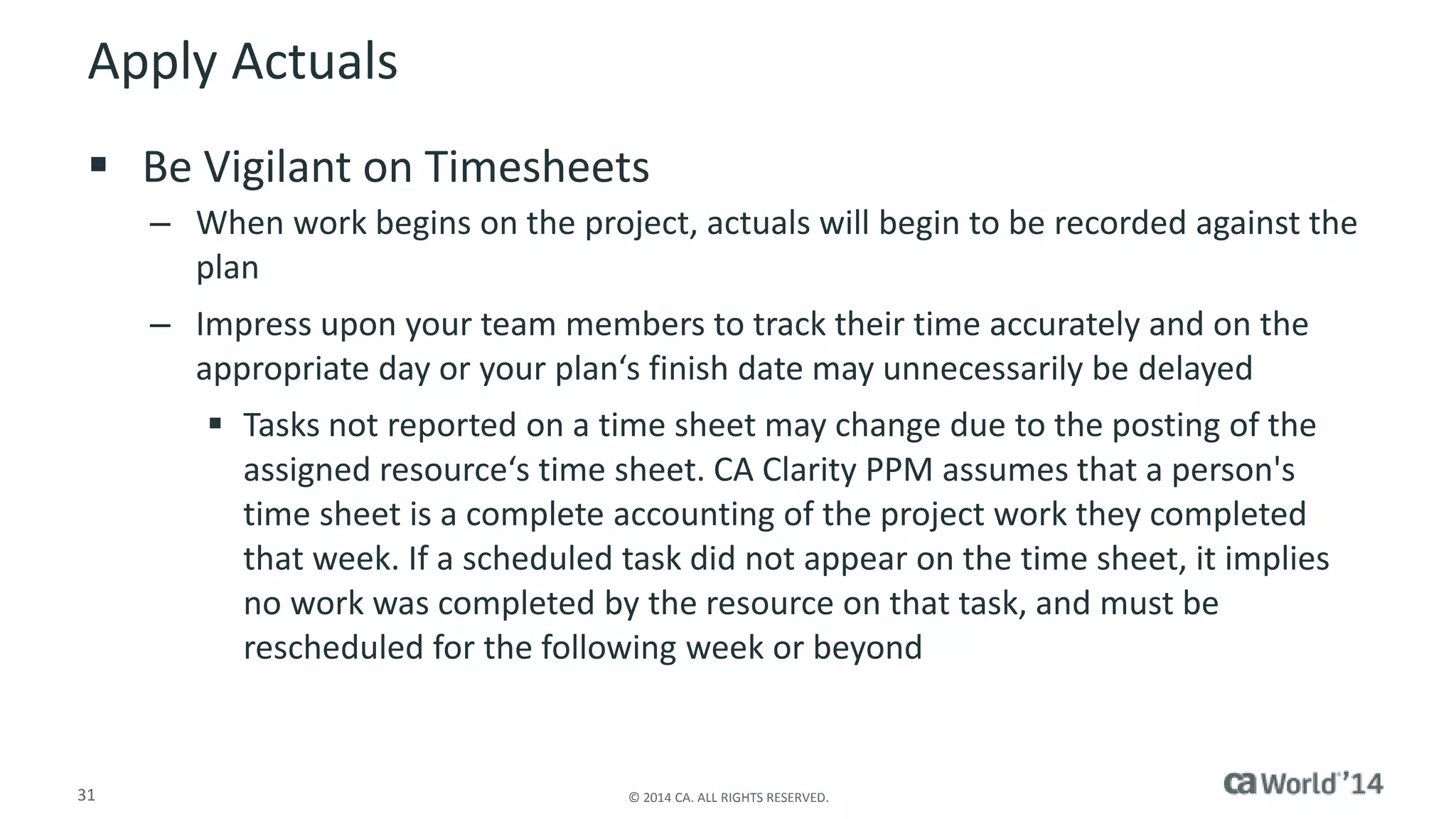

Apply Actuals
 Be Vigilant on Timesheets
– When work begins on the project, actuals will begin to be recorded against the
plan
– Impress upon your team members to track their time accurately and on the
appropriate day or your plan‘s finish date may unnecessarily be delayed
 Tasks not reported on a time sheet may change due to the posting of the
assigned resource‘s time sheet. CA Clarity PPM assumes that a person's
time sheet is a complete accounting of the project work they completed
that week. If a scheduled task did not appear on the time sheet, it implies
no work was completed by the resource on that task, and must be
rescheduled for the following week or beyond
31 © 2014 CA. ALL RIGHTS RESERVED.

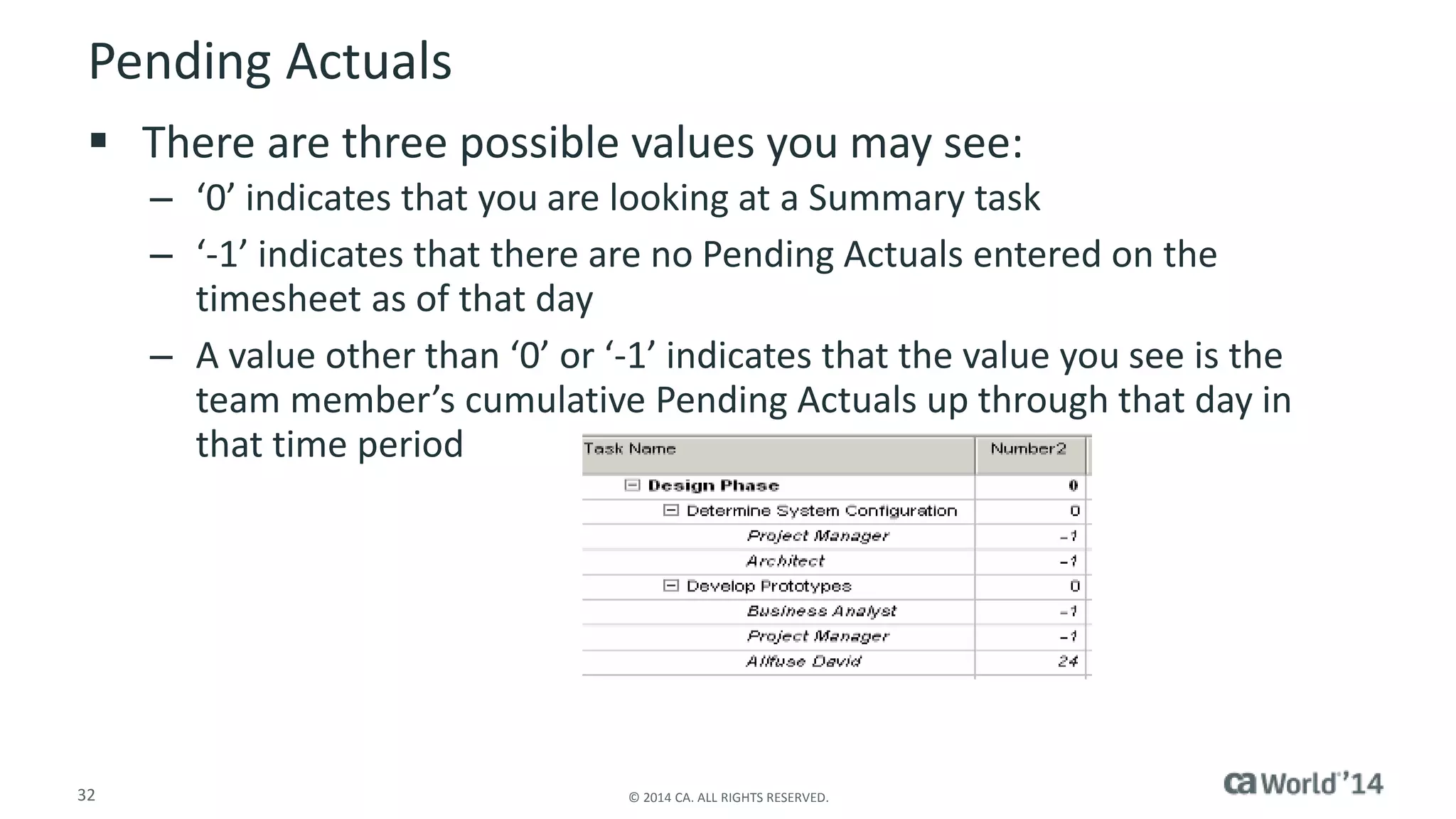

Pending Actuals
 There are three possible values you may see:
– ‘0’ indicates that you are looking at a Summary task
– ‘-1’ indicates that there are no Pending Actuals entered on the
timesheet as of that day
– A value other than ‘0’ or ‘-1’ indicates that the value you see is the
team member’s cumulative Pending Actuals up through that day in
that time period
32 © 2014 CA. ALL RIGHTS RESERVED.

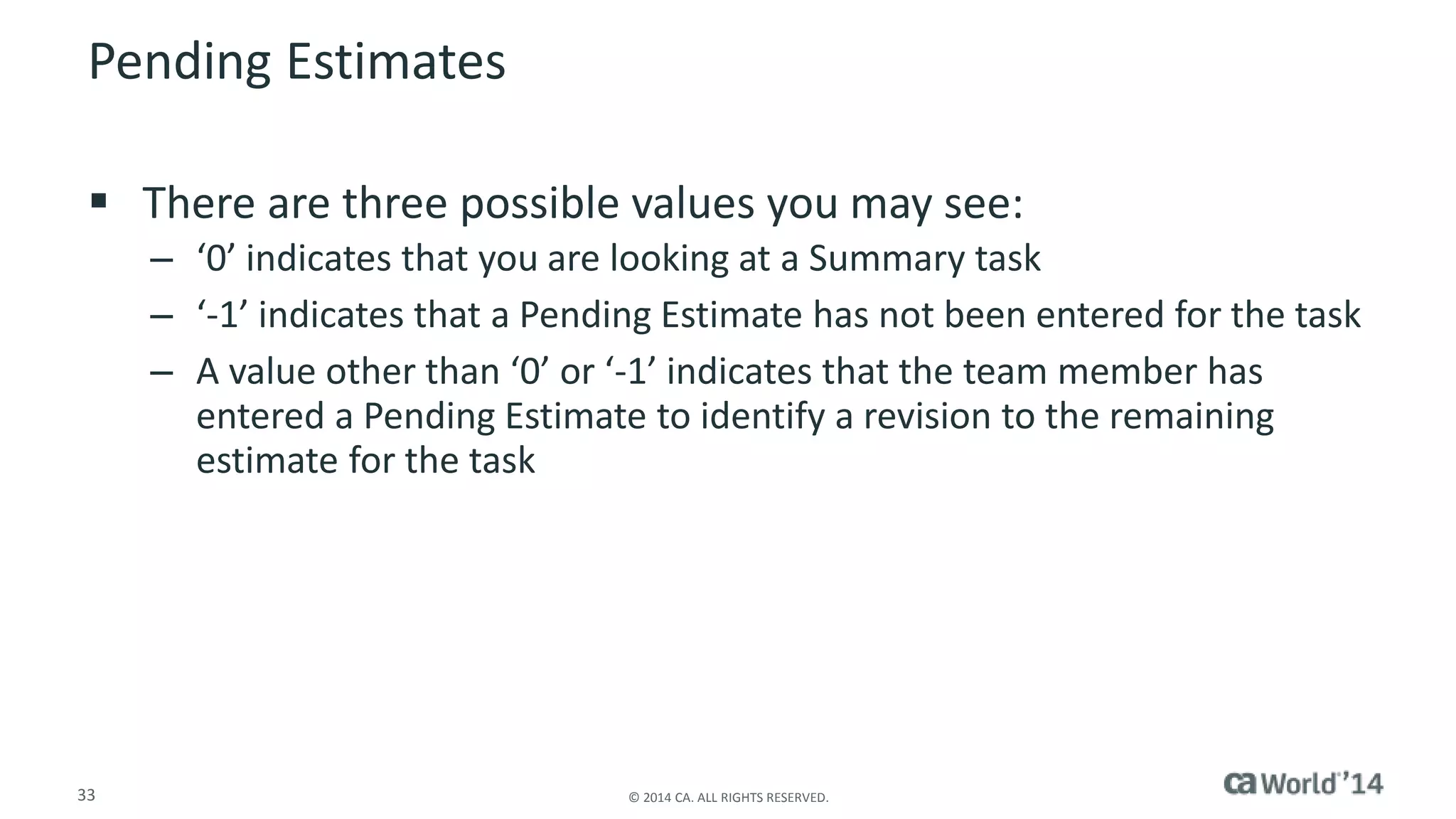

Pending Estimates
 There are three possible values you may see:
– ‘0’ indicates that you are looking at a Summary task
– ‘-1’ indicates that a Pending Estimate has not been entered for the task
– A value other than ‘0’ or ‘-1’ indicates that the team member has
entered a Pending Estimate to identify a revision to the remaining
estimate for the task
33 © 2014 CA. ALL RIGHTS RESERVED.

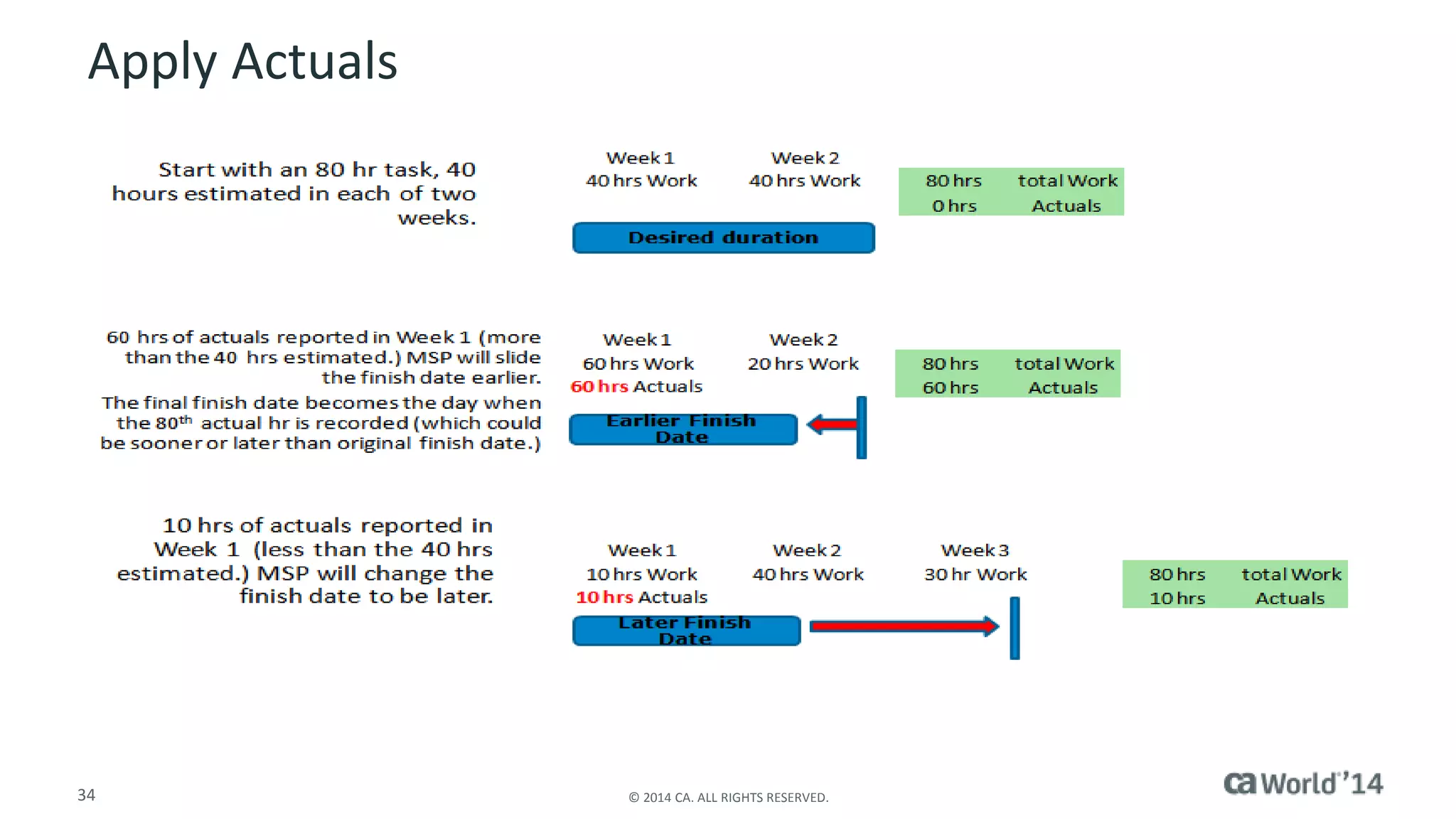

Apply Actuals
34 © 2014 CA. ALL RIGHTS RESERVED.

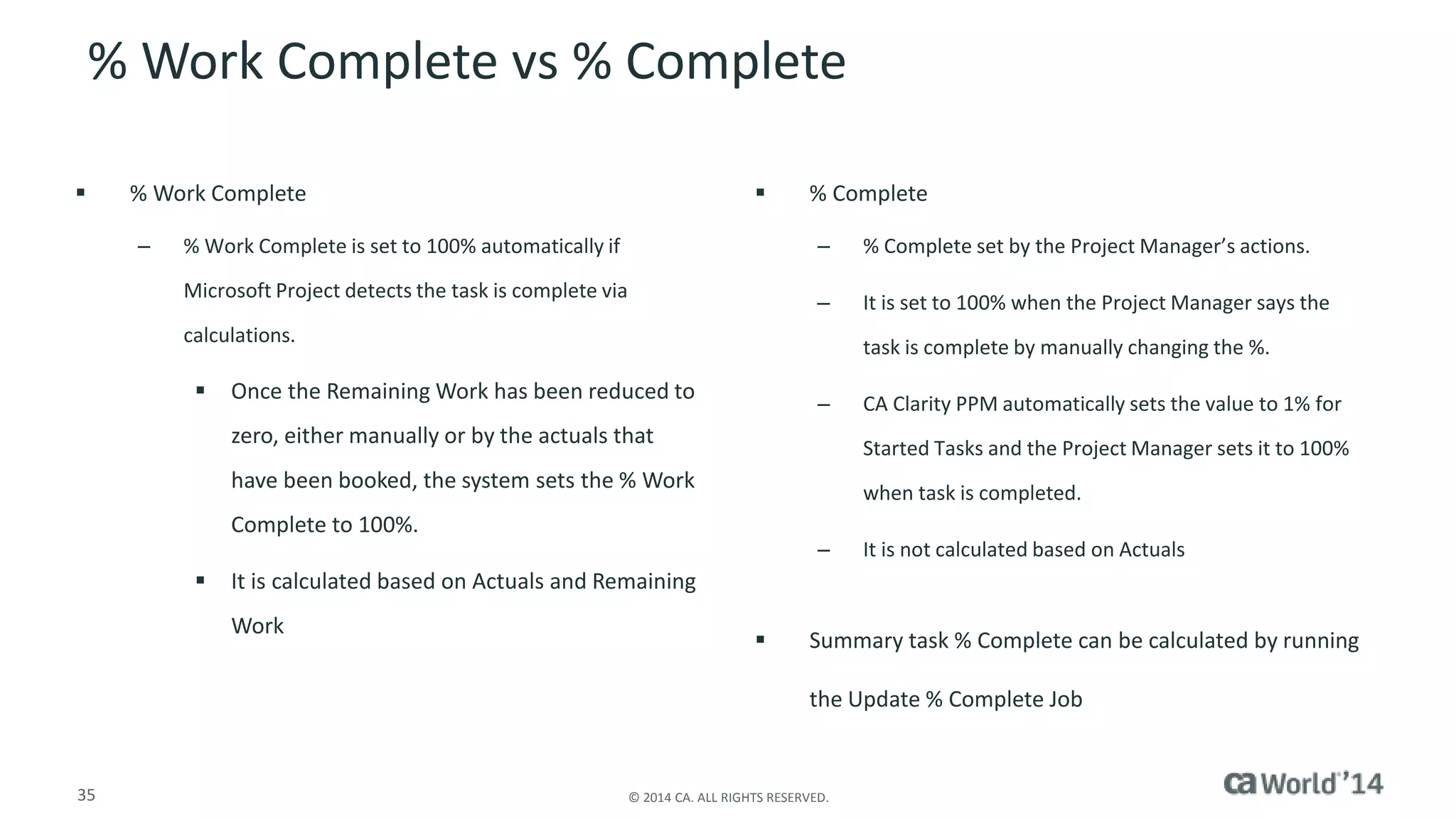

% Work Complete vs % Complete
 % Work Complete
– % Work Complete is set to 100% automatically if
Microsoft Project detects the task is complete via
calculations.
 Once the Remaining Work has been reduced to
zero, either manually or by the actuals that
have been booked, the system sets the % Work
Complete to 100%.
 It is calculated based on Actuals and Remaining
Work
 % Complete
– % Complete set by the Project Manager’s actions.
– It is set to 100% when the Project Manager says the
35 © 2014 CA. ALL RIGHTS RESERVED.
task is complete by manually changing the %.
– CA Clarity PPM automatically sets the value to 1% for
Started Tasks and the Project Manager sets it to 100%
when task is completed.
– It is not calculated based on Actuals
 Summary task % Complete can be calculated by running
the Update % Complete Job
For More Information
Insert appropriate screenshot and text overlay
from following “More Info Graphics” slide here;
Management Cloud
ensure it links to correct page
To learn more about Management Cloud,
please visit:
http://bit.ly/1wEnPhz
36 © 2014 CA. ALL RIGHTS RESERVED.
For Informational Purposes Only
Terms of this Presentation
© 2014 CA. All rights reserved. All trademarks referenced herein belong to their respective companies.
This presentation provided at CA World 2014 is intended for information purposes only and does not form any type of warranty.
Some of the specific slides with customer references relate to customer's specific use and experience of CA products and solutions so actual
results may vary.
37 © 2014 CA. ALL RIGHTS RESERVED.

MS Project Integration: Tips, Tricks and What's New for You

  • 1.
    ca Intellicenter MSProject Integration: Tips, Tricks and What's New for You Mindy Calderon Senior Instructor, North America CA Technologies ICX17E #CAWorld
  • 2.
    Abstract  Haveyou scheduled in Microsoft Project (MSP) and are now presented with the "Tasks" to maintain a schedule in CA Clarity? Is your organization using CA Clarity but still wants to schedule in MS Project? Have you noticed that the logic in how CA Clarity schedules is different in MS Project? And most importantly - wouldn't it be awesome to be able to explain why CA Clarity and MS Project behave differently but ultimately get you the same result? The session will show you where and how MSP and CA Clarity bi-directionally map data, how to create and manage tasks, assignments and scheduling, as well as updating task status and work. It includes a broad discussion where and when data should be entered in Clarity and MS Project, on defining data elements and how to capture them. Mindy Calderon CA Technologies Senior Instructor 2 © 2014 CA. ALL RIGHTS RESERVED.
  • 3.
    Agenda INTEGRATION OVERVIEW CUSTOM VIEWS WORK BREAKDOWN STRUCTURE RESOURCES AND MS PROJECT Q & A 3 © 2014 CA. ALL RIGHTS RESERVED.
  • 4.
    Summary A FewWords to Describe MS Project Integration with Clarity Results MS Project and CA Clarity PPM bi-directionally maps data, manages tasks, assignments and scheduling as well as updating task status. The Clarity project acts as the ‘umbrella’ for PM methodology . The result is a project that follows Project Management and Scheduling standards. 4 © 2014 CA. ALL RIGHTS RESERVED.
  • 5.
    Definitions INTEGRATION –BIDIRECTIONAL DATA FLOW USING NEW XML DRIVER METHODOLOGY – CONSISTENT AND REPEATABLE SCHEDULING AND MANAGING PROCESSES * * This is NOT a Technical Session: Understand from a Functional Perspective 5 © 2014 CA. ALL RIGHTS RESERVED.
  • 6.
  • 7.
    Identify the MSProject Integration  Schedule Projects – Microsoft Project  Set Scheduler Format attribute default to Microsoft Project  PICK ONE AND STICK WITH IT! – Per project 7 © 2014 CA. ALL RIGHTS RESERVED.
  • 8.
    Identify and Installthe MSP Interface 8 © 2014 CA. ALL RIGHTS RESERVED.
  • 9.
    Bi-Directional  Newxml file – same location as the .mpp file  Usually in the My Documents folder  Supportable – old integration no longer supported by Microsoft  When you launch a plan from the CA Clarity PPM screen, it exports this plan to your local client system.  After you complete updating your session from within Microsoft Project, you will select Save from the Clarity Integration toolbar to retain your updates 9 © 2014 CA. ALL RIGHTS RESERVED.
  • 10.
    Install the MSPInterface Tips 10 © 2014 CA. ALL RIGHTS RESERVED.
  • 11.
    Set Defaults andOptions 11 © 2014 CA. ALL RIGHTS RESERVED.
  • 12.
    Set Defaults andOptions Continued  Tips – At a minimum, you must set the File – Project Option defaults at the application level – Additionally, you will want to check and modify these settings on the individual projects that were created before you adjusted these File – Project Option defaults – These projects would have inherited the former default settings – Application Level Defaults allow all new projects to inherit the default settings. – Setting should also be reset for Legacy projects that are being brought into CA Clarity PPM 12 © 2014 CA. ALL RIGHTS RESERVED.
  • 13.
    Identify Field Mappings 13 © 2014 CA. ALL RIGHTS RESERVED.
  • 14.
    Custom Views andCreating a Project
  • 15.
    Custom Views Gantt Chart View ̶ Add the Key Task Column ̶ Add the Charge Code Column – Only if you let Users select  Task Usage View ̶ actual work ̶ remaining  Custom View ̶ Combined View  Gantt Chart on the top  Task Usage on bottom Modify Existing Views to Create Custom Views 15 © 2014 CA. ALL RIGHTS RESERVED.
  • 16.
    Create Projects –RULE OF THUMB  Anything on the Properties Tab and Team Tab – Enter/Edit/Update in CA Clarity  Anything on the Tasks Tab – Enter/Edit/Update in MS Project Anything on the Tasks Tab Enter/Edit/Update in MS Project 16 © 2014 CA. ALL RIGHTS RESERVED.
  • 17.
  • 18.
    Resources and MSProject  Staff a Plan – Should ALWAYS be done in CA Clarity – Resource Allocation button Holistic View of Availability Resource Planning Views 18 © 2014 CA. ALL RIGHTS RESERVED.
  • 19.
    The Four (4)A’s  Availability  Allocation  Assignment  Actuals Holistic View of Availability and Allocation Resource Planning Views 19 © 2014 CA. ALL RIGHTS RESERVED.
  • 20.
    Work Breakdown Structure There are often misunderstandings about the meanings of the terms “duration” and “work” A task has duration amount and work amount, which may not always be equivalent values
  • 21.
    Define Work, Unitsand Duration  For a Fixed Units task, Microsoft Project recalculates Duration when you overwrite the Fixed Units value  For a Fixed Duration task, Microsoft Project recalculates Work when you overwrite the Fixed Duration value  For a Fixed Work task, Microsoft Project recalculates Duration when you overwrite the Fixed Work value 21 © 2014 CA. ALL RIGHTS RESERVED.
  • 22.
    Identify Task ManagementGuidelines Terminology Differences Between CA Clarity PPM and Microsoft Project 22 © 2014 CA. ALL RIGHTS RESERVED.
  • 23.
    Identify Task ManagementGuidelines Terminology Differences Between CA Clarity PPM and Microsoft Project Continued 23 © 2014 CA. ALL RIGHTS RESERVED.
  • 24.
    Determine the Schedule  Some of the common elements of Project Management get a bit more complicated when using CA Clarity and Microsoft Project together  Status = Complete – Microsoft Project  Zero out remaining work for all resource assignments – CA Clarity 24 © 2014 CA. ALL RIGHTS RESERVED.  Zero-out the Estimate to Complete value, select ‘Completed’ from the drop-down in the ‘Status’ field  Remaining Work & Pending Estimate To Complete – Entry Precedence – Work Contour – Summary Tasks – Blank Task Names
  • 25.
  • 26.
    Baseline the Project  A Baseline will create a point-in-time capture of your project plan that you can refer to, and measure against – Baselines can include either the full or partial project WBS  Update to existing baselines – Full baseline – Update partial (tasks) baseline 26 © 2014 CA. ALL RIGHTS RESERVED.
  • 27.
    Baseline the Project  CA Clarity PPM can only have one Baseline active, but Microsoft Project can view several at a time  Microsoft Project can store 11 baselines, while CA Clarity PPM can store as many as you need – If there are more than 11 project baselines stored in CA Clarity PPM, the latest 11 will download to Microsoft Project when you open the project  CA Clarity PPM has security rights associated with creating and modifying baselines – you will still be able to run the baseline functionality in Microsoft Project, but the data will not be saved to CA Clarity PPM 27 © 2014 CA. ALL RIGHTS RESERVED.
  • 28.
    Define Track ModeSettings  This setting permits or restricts a 28 © 2014 CA. ALL RIGHTS RESERVED. specific project from accepting actuals from a timesheet and/or permits the project manager to enter actuals directly into the project plan  The Track Mode is found in two locations: – Project level: Properties > Schedule – Resource level: Properties
  • 29.
    Define Track ModeSettings  The following chart contains rules surrounding the capture of actuals using CA Clarity PPM Timesheets in conjunction with Microsoft Project 29 © 2014 CA. ALL RIGHTS RESERVED.
  • 30.
    Tips  Resourcescan be open for time entry at the resource, project and project assignment level. If a resource is not open for time entry in all three places, they are not able to use CA Clarity PPM timesheets.  Time periods should be created and status (open or closed) should be managed by an application administrator  Timesheets are submitted, approved and posted in CA Clarity PPM Timesheets – only posted timesheets appear as actuals – Actuals on Timesheets, which have been saved but not yet posted, will appear as Pending Actuals in Microsoft Project. These can be viewed using MSP mapping – Do not update Actuals in Microsoft Project if the Track Mode is Clarity or Other 30 © 2014 CA. ALL RIGHTS RESERVED.
  • 31.
    Apply Actuals Be Vigilant on Timesheets – When work begins on the project, actuals will begin to be recorded against the plan – Impress upon your team members to track their time accurately and on the appropriate day or your plan‘s finish date may unnecessarily be delayed  Tasks not reported on a time sheet may change due to the posting of the assigned resource‘s time sheet. CA Clarity PPM assumes that a person's time sheet is a complete accounting of the project work they completed that week. If a scheduled task did not appear on the time sheet, it implies no work was completed by the resource on that task, and must be rescheduled for the following week or beyond 31 © 2014 CA. ALL RIGHTS RESERVED.
  • 32.
    Pending Actuals There are three possible values you may see: – ‘0’ indicates that you are looking at a Summary task – ‘-1’ indicates that there are no Pending Actuals entered on the timesheet as of that day – A value other than ‘0’ or ‘-1’ indicates that the value you see is the team member’s cumulative Pending Actuals up through that day in that time period 32 © 2014 CA. ALL RIGHTS RESERVED.
  • 33.
    Pending Estimates There are three possible values you may see: – ‘0’ indicates that you are looking at a Summary task – ‘-1’ indicates that a Pending Estimate has not been entered for the task – A value other than ‘0’ or ‘-1’ indicates that the team member has entered a Pending Estimate to identify a revision to the remaining estimate for the task 33 © 2014 CA. ALL RIGHTS RESERVED.
  • 34.
    Apply Actuals 34© 2014 CA. ALL RIGHTS RESERVED.
  • 35.
    % Work Completevs % Complete  % Work Complete – % Work Complete is set to 100% automatically if Microsoft Project detects the task is complete via calculations.  Once the Remaining Work has been reduced to zero, either manually or by the actuals that have been booked, the system sets the % Work Complete to 100%.  It is calculated based on Actuals and Remaining Work  % Complete – % Complete set by the Project Manager’s actions. – It is set to 100% when the Project Manager says the 35 © 2014 CA. ALL RIGHTS RESERVED. task is complete by manually changing the %. – CA Clarity PPM automatically sets the value to 1% for Started Tasks and the Project Manager sets it to 100% when task is completed. – It is not calculated based on Actuals  Summary task % Complete can be calculated by running the Update % Complete Job
  • 36.
    For More Information Insert appropriate screenshot and text overlay from following “More Info Graphics” slide here; Management Cloud ensure it links to correct page To learn more about Management Cloud, please visit: http://bit.ly/1wEnPhz 36 © 2014 CA. ALL RIGHTS RESERVED.
  • 37.
    For Informational PurposesOnly Terms of this Presentation © 2014 CA. All rights reserved. All trademarks referenced herein belong to their respective companies. This presentation provided at CA World 2014 is intended for information purposes only and does not form any type of warranty. Some of the specific slides with customer references relate to customer's specific use and experience of CA products and solutions so actual results may vary. 37 © 2014 CA. ALL RIGHTS RESERVED.
