Pre-Con Education: CA Project and Portfolio
Management v14.x MS Project Integration
Tips, Tricks and What’s New for You
Kismet Silva-Smith
Agile Management
CA Technologies
Instructor
AMX05E
@TwitterHandle
#CAWorld
2 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
For Informational Purposes Only
Terms of this Presentation
© 2015 CA. All rights reserved. All trademarks referenced herein belong to their respective companies. The presentation provided at CA
World 2015 is intended for information purposes only and does not form any type of warranty. Some of the specific slides with customer
references relate to customer's specific use and experience of CA products and solutions so actual results may vary.
Certain information in this presentation may outline CA’s general product direction. This presentation shall not serve to (i) affect the rights
and/or obligations of CA or its licensees under any existing or future license agreement or services agreement relating to any CA software
product; or (ii) amend any product documentation or specifications for any CA software product. This presentation is based on current
information and resource allocations as of November 18, 2015, and is subject to change or withdrawal by CA at any time without notice. The
development, release and timing of any features or functionality described in this presentation remain at CA’s sole discretion.
Notwithstanding anything in this presentation to the contrary, upon the general availability of any future CA product release referenced in
this presentation, CA may make such release available to new licensees in the form of a regularly scheduled major product release. Such
release may be made available to licensees of the product who are active subscribers to CA maintenance and support, on a when and if-
available basis. The information in this presentation is not deemed to be incorporated into any contract.
3 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

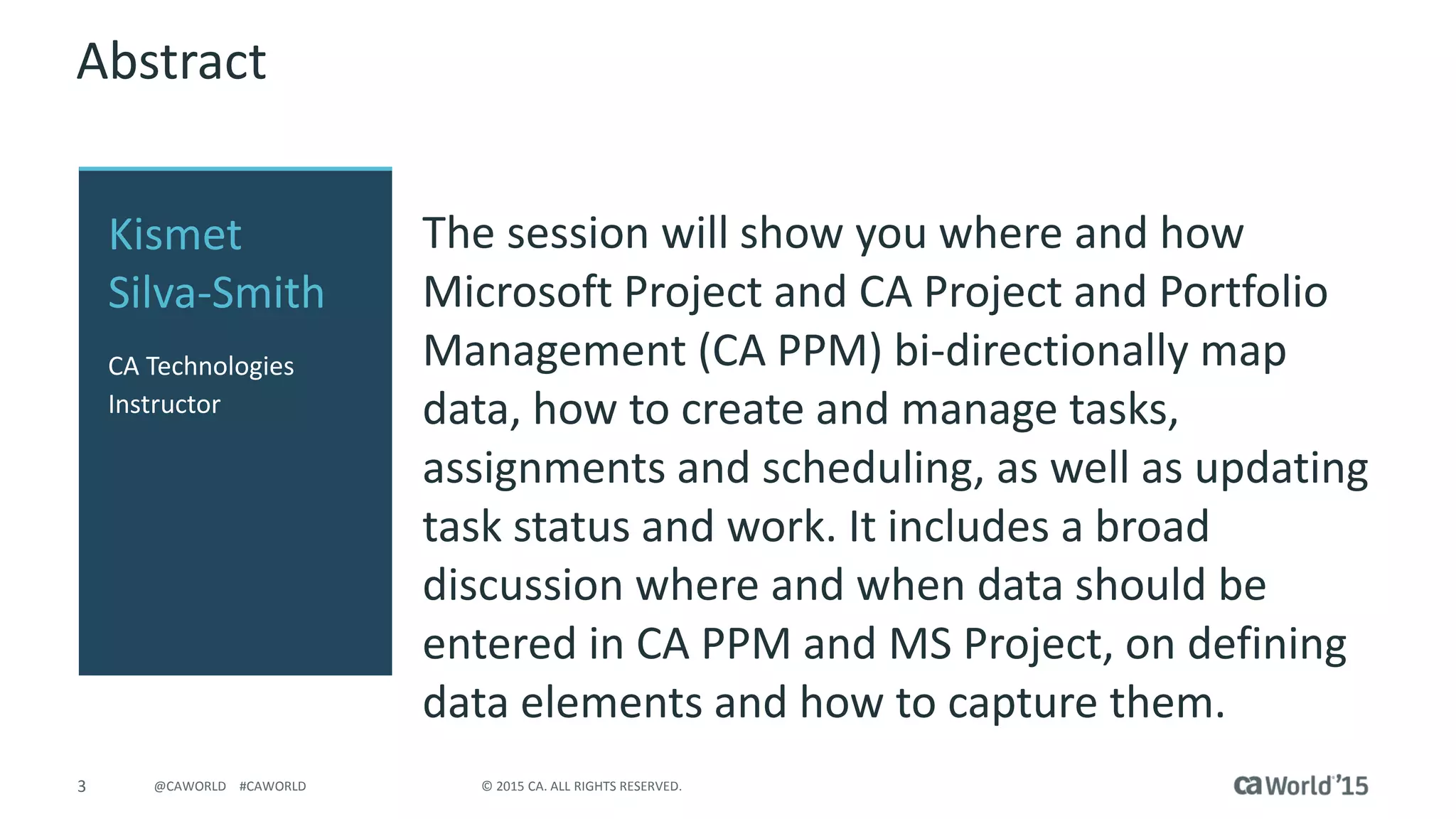

Abstract
The session will show you where and how
Microsoft Project and CA Project and Portfolio
Management (CA PPM) bi-directionally map
data, how to create and manage tasks,
assignments and scheduling, as well as updating
task status and work. It includes a broad
discussion where and when data should be
entered in CA PPM and MS Project, on defining
data elements and how to capture them.
Kismet
Silva-Smith
CA Technologies
Instructor
4 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

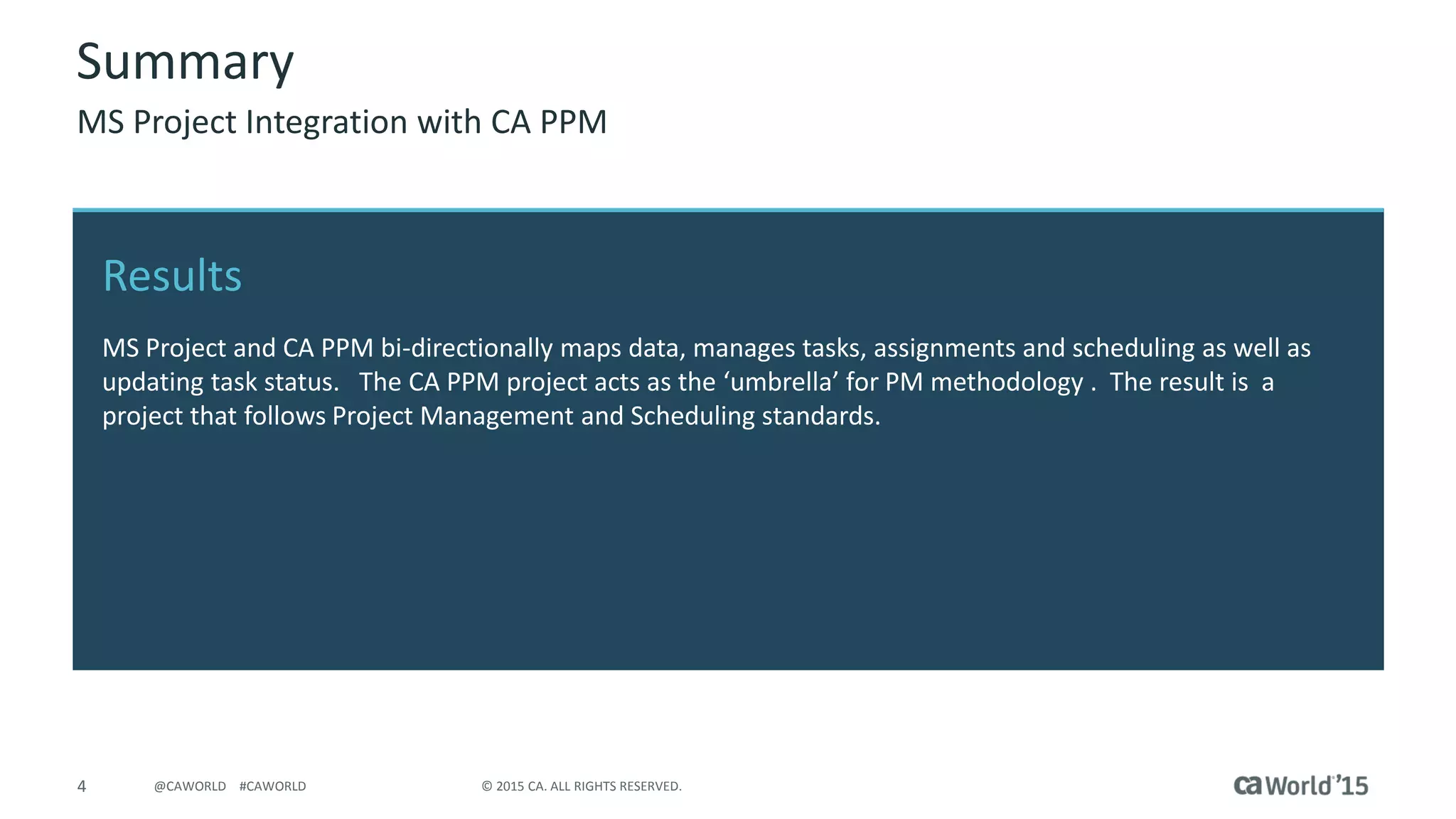

Results
MS Project and CA PPM bi-directionally maps data, manages tasks, assignments and scheduling as well as
updating task status. The CA PPM project acts as the ‘umbrella’ for PM methodology . The result is a
project that follows Project Management and Scheduling standards.
Summary
MS Project Integration with CA PPM
5 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

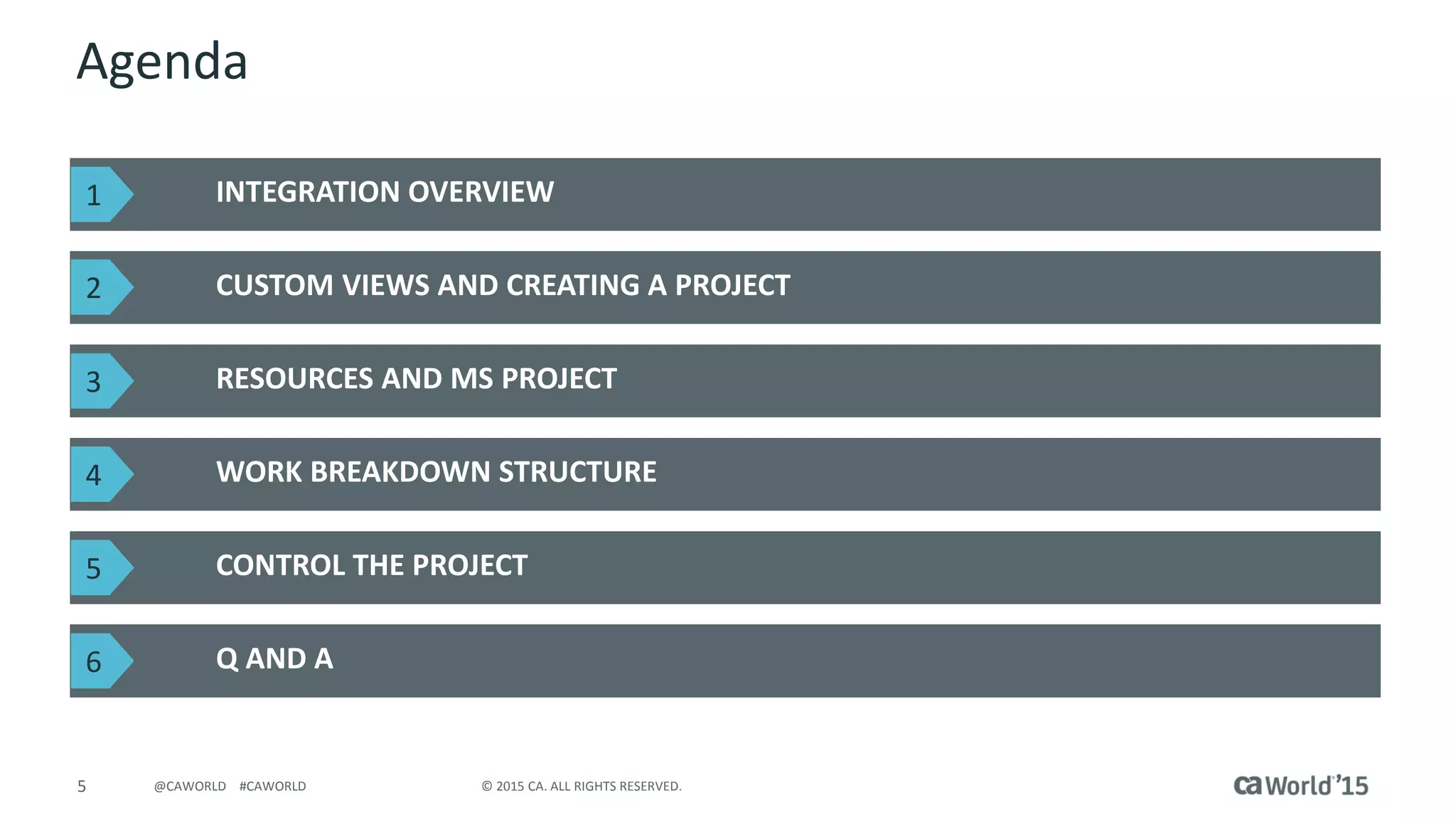

Agenda
INTEGRATION OVERVIEW
CUSTOM VIEWS AND CREATING A PROJECT
Q AND A
RESOURCES AND MS PROJECT
WORK BREAKDOWN STRUCTURE
CONTROL THE PROJECT
1
2
3
4
5
6
6 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Integration Overview
7 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

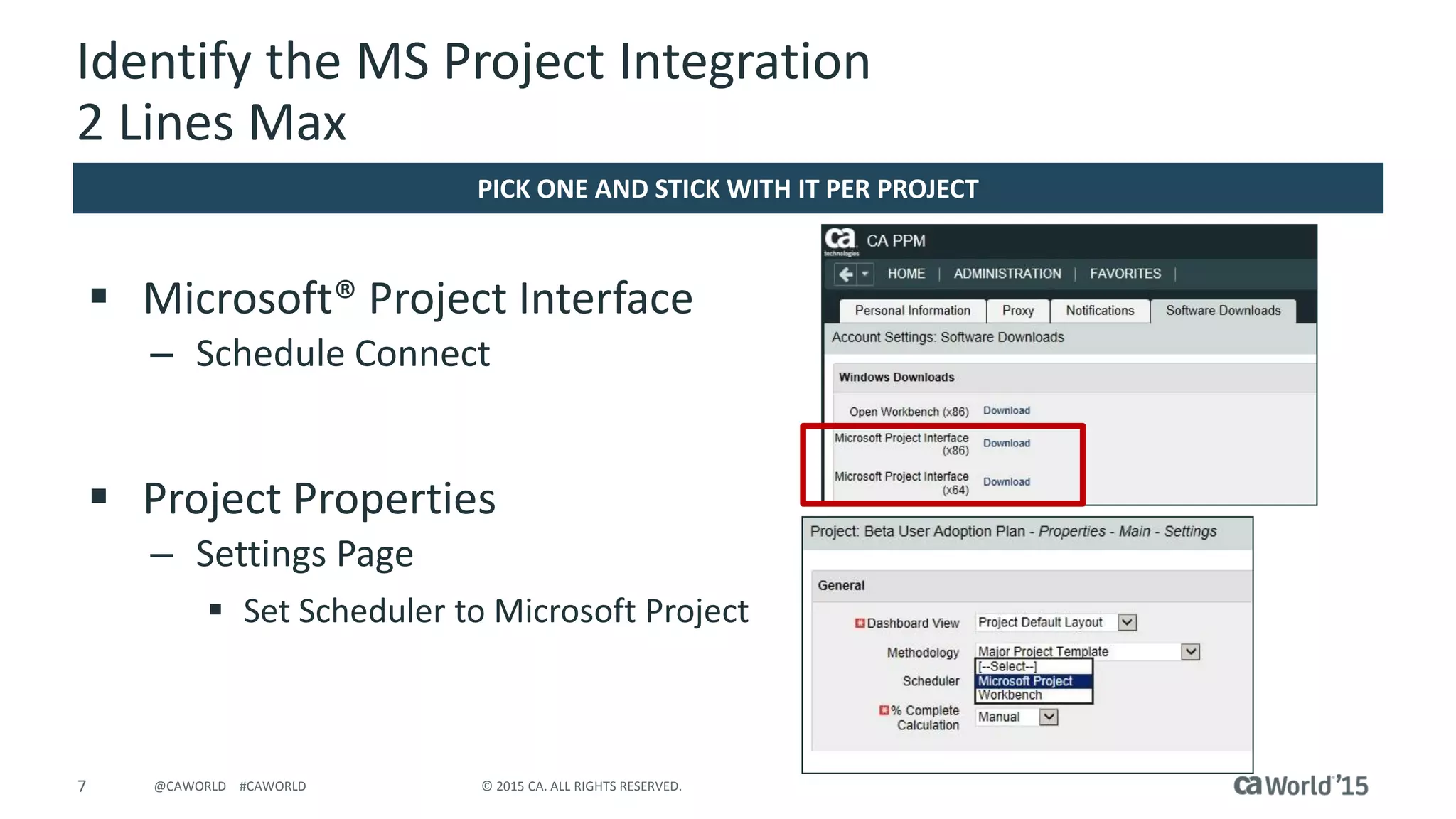

Identify the MS Project Integration
2 Lines Max
 Microsoft® Project Interface
– Schedule Connect
 Project Properties
– Settings Page
 Set Scheduler to Microsoft Project
PICK ONE AND STICK WITH IT PER PROJECT
8 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

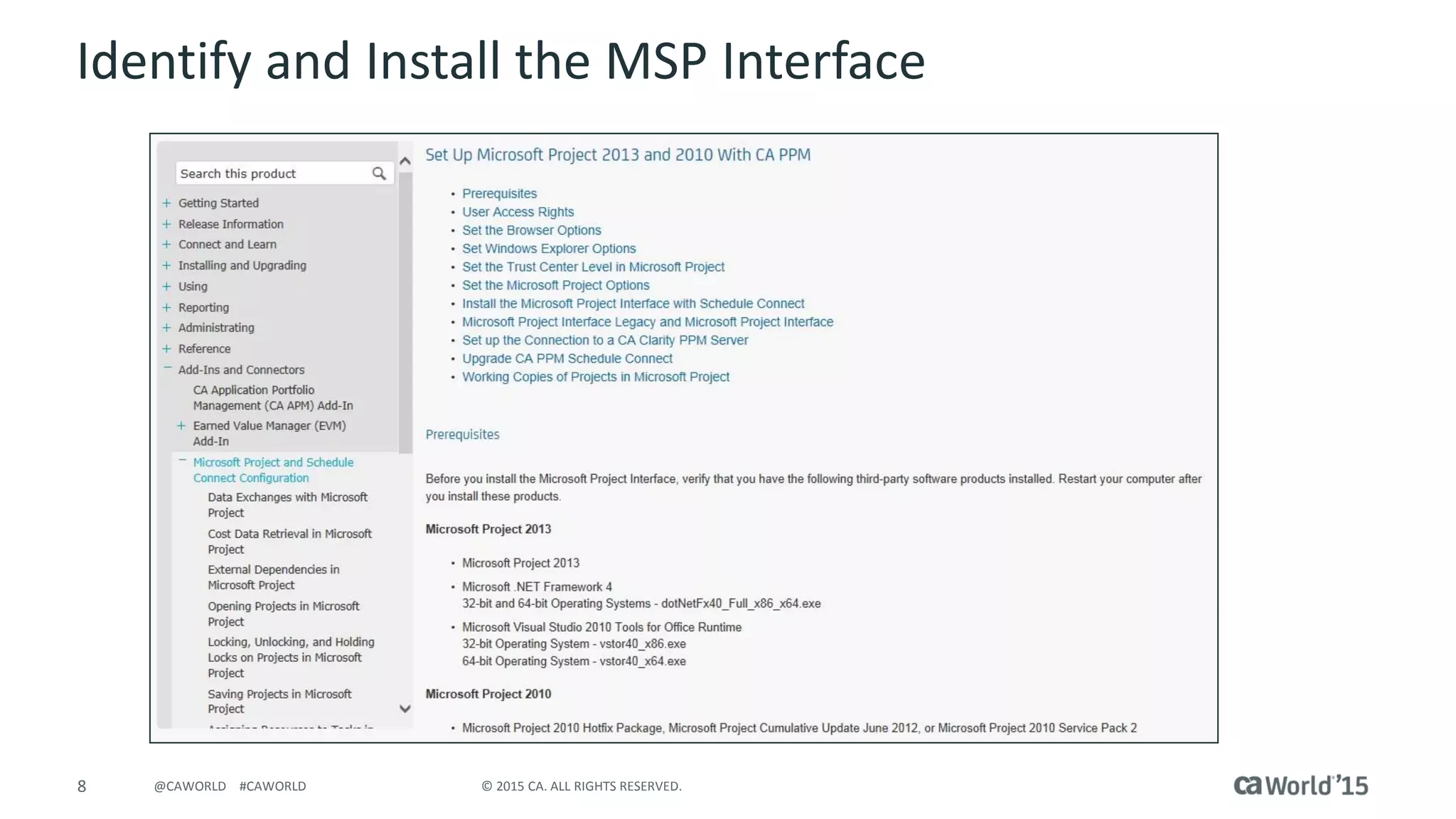

Identify and Install the MSP Interface
9 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

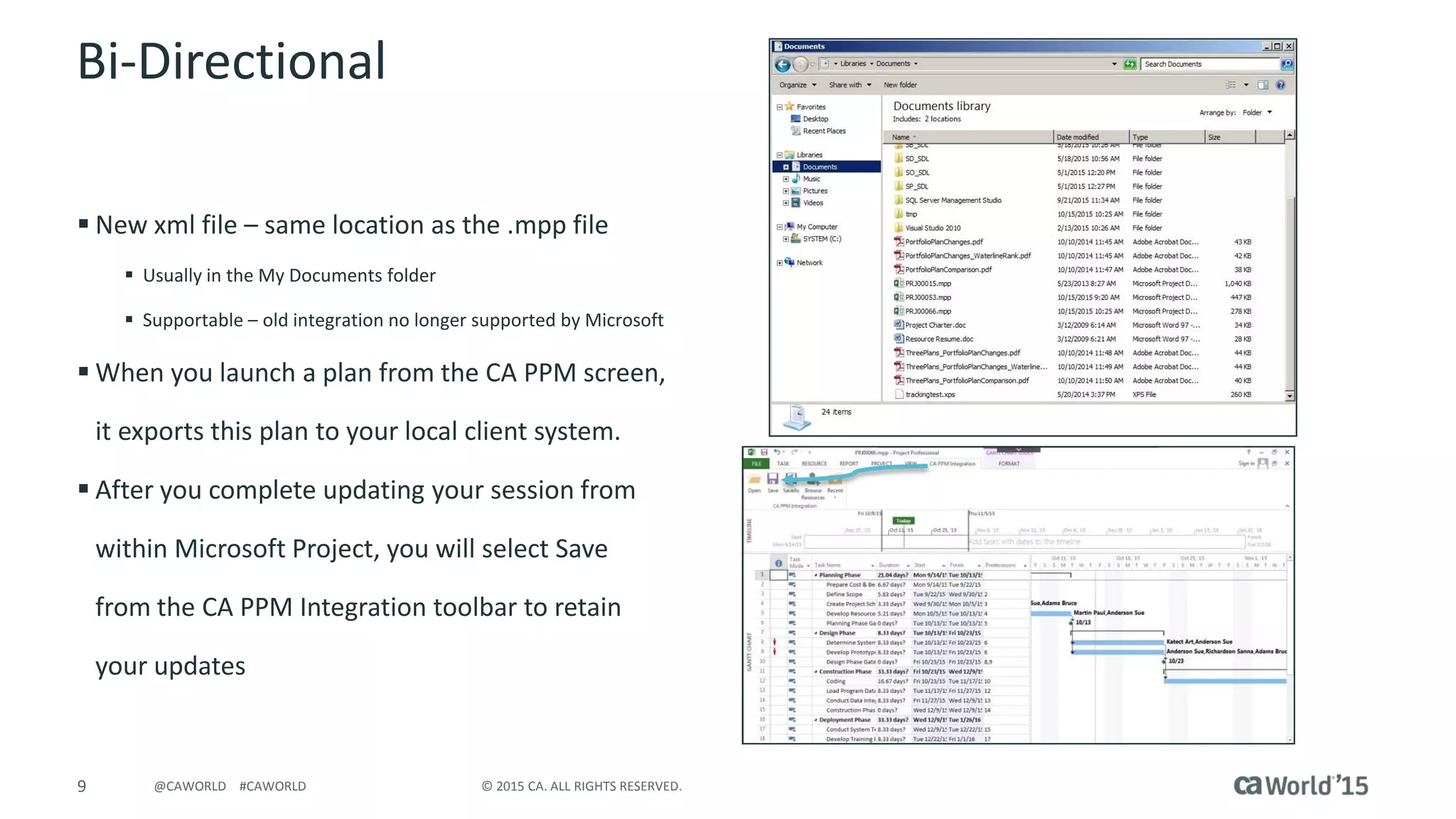

Bi-Directional
 New xml file – same location as the .mpp file
 Usually in the My Documents folder
 Supportable – old integration no longer supported by Microsoft
 When you launch a plan from the CA PPM screen,
it exports this plan to your local client system.
 After you complete updating your session from
within Microsoft Project, you will select Save
from the CA PPM Integration toolbar to retain
your updates
10 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

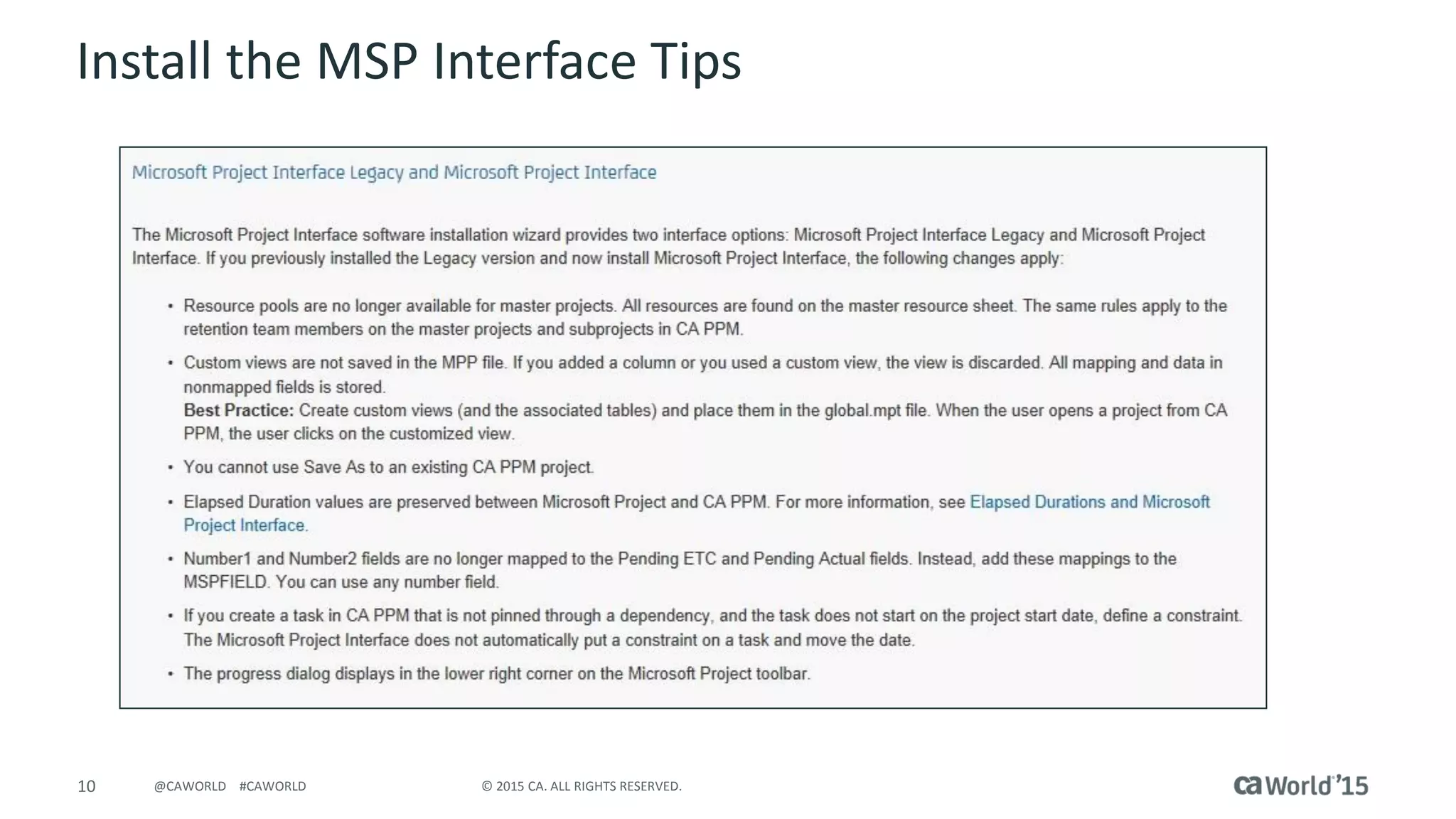

Install the MSP Interface Tips
11 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

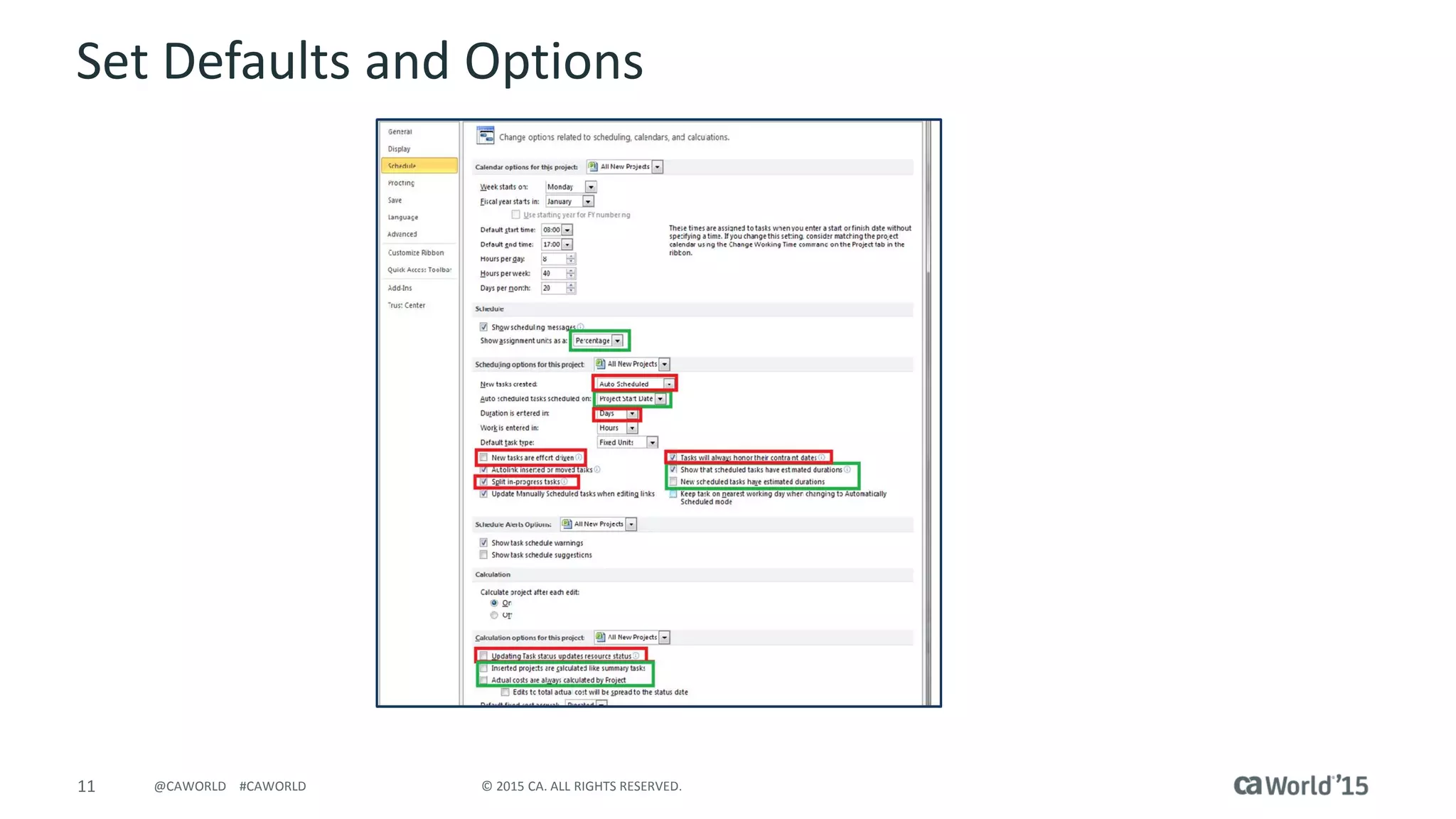

Set Defaults and Options
12 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

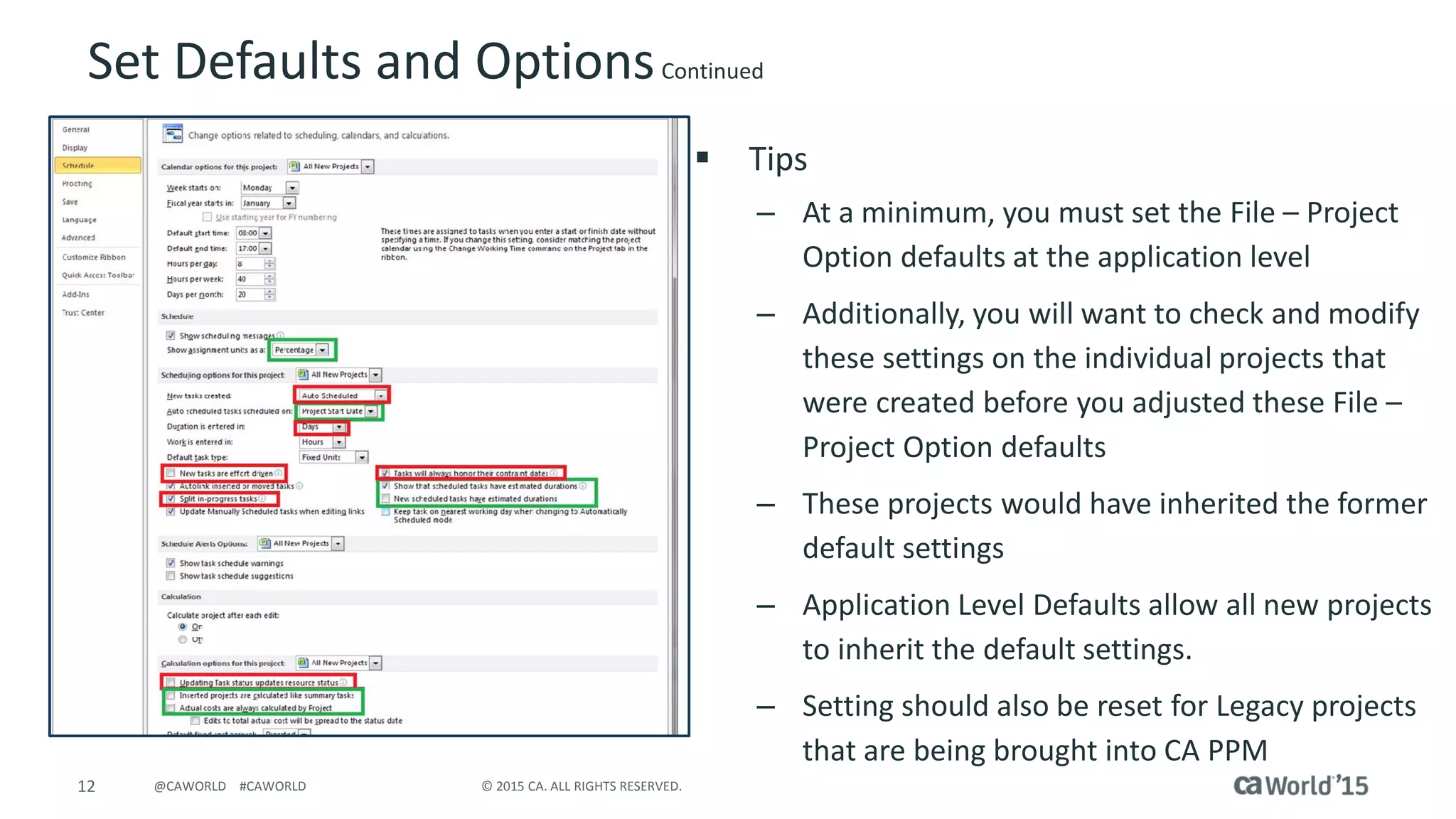

Set Defaults and OptionsContinued
 Tips
– At a minimum, you must set the File – Project
Option defaults at the application level
– Additionally, you will want to check and modify
these settings on the individual projects that
were created before you adjusted these File –
Project Option defaults
– These projects would have inherited the former
default settings
– Application Level Defaults allow all new projects
to inherit the default settings.
– Setting should also be reset for Legacy projects
that are being brought into CA PPM
13 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

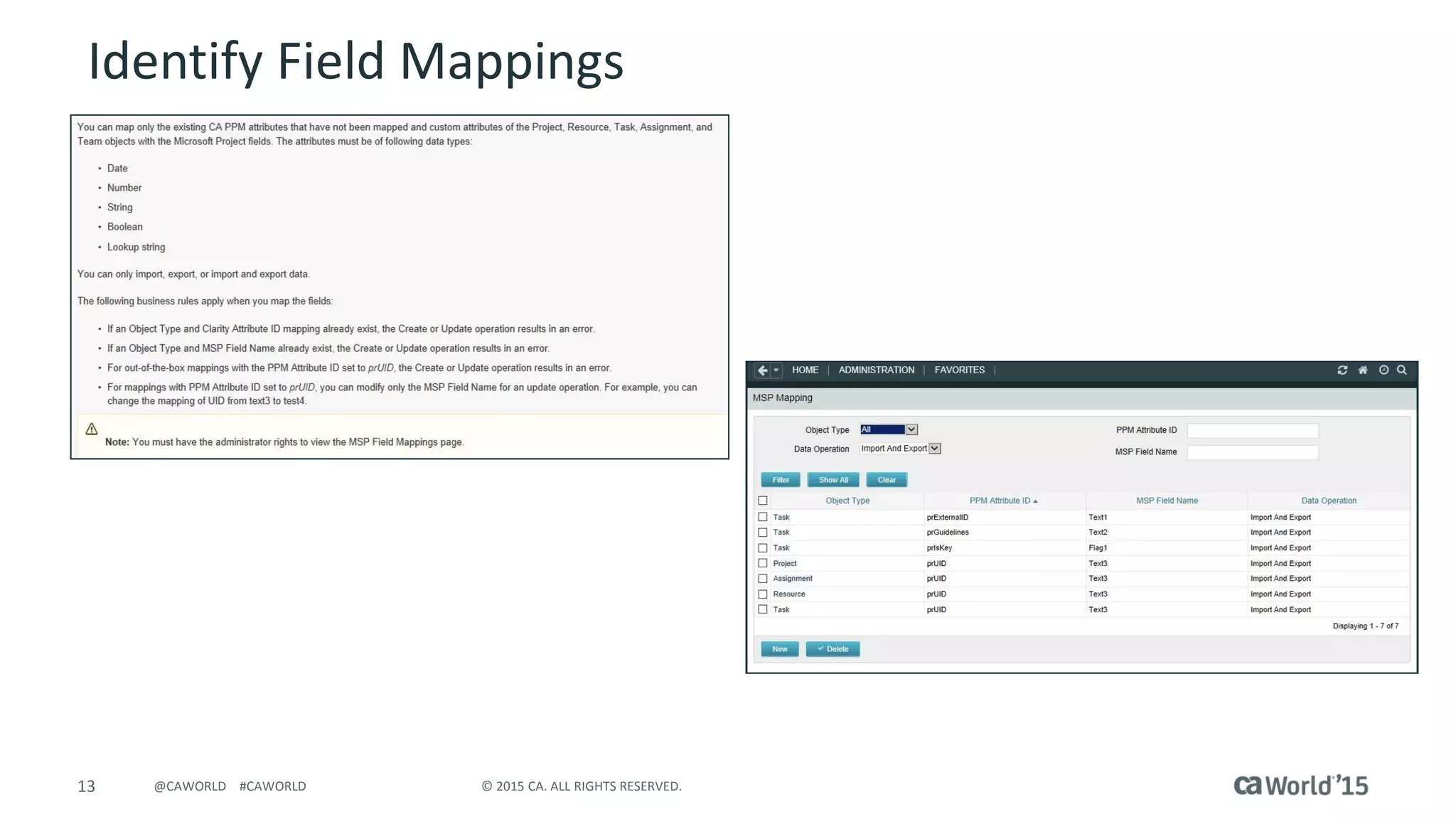

Identify Field Mappings
14 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Custom Views and Creating a Project
15 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

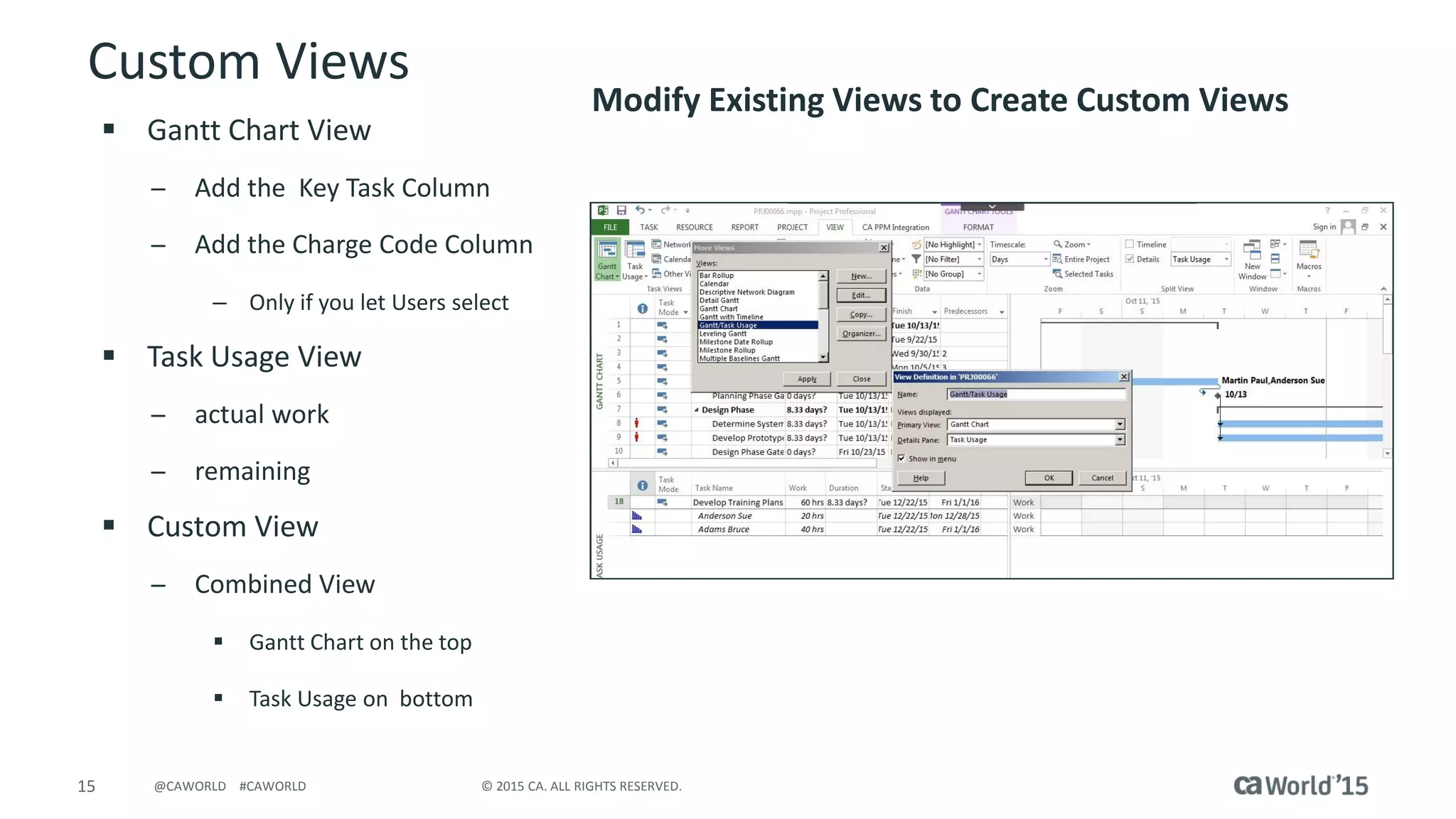

Custom Views
 Gantt Chart View
̶ Add the Key Task Column
̶ Add the Charge Code Column
– Only if you let Users select
 Task Usage View
̶ actual work
̶ remaining
 Custom View
̶ Combined View
 Gantt Chart on the top
 Task Usage on bottom
Modify Existing Views to Create Custom Views
16 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

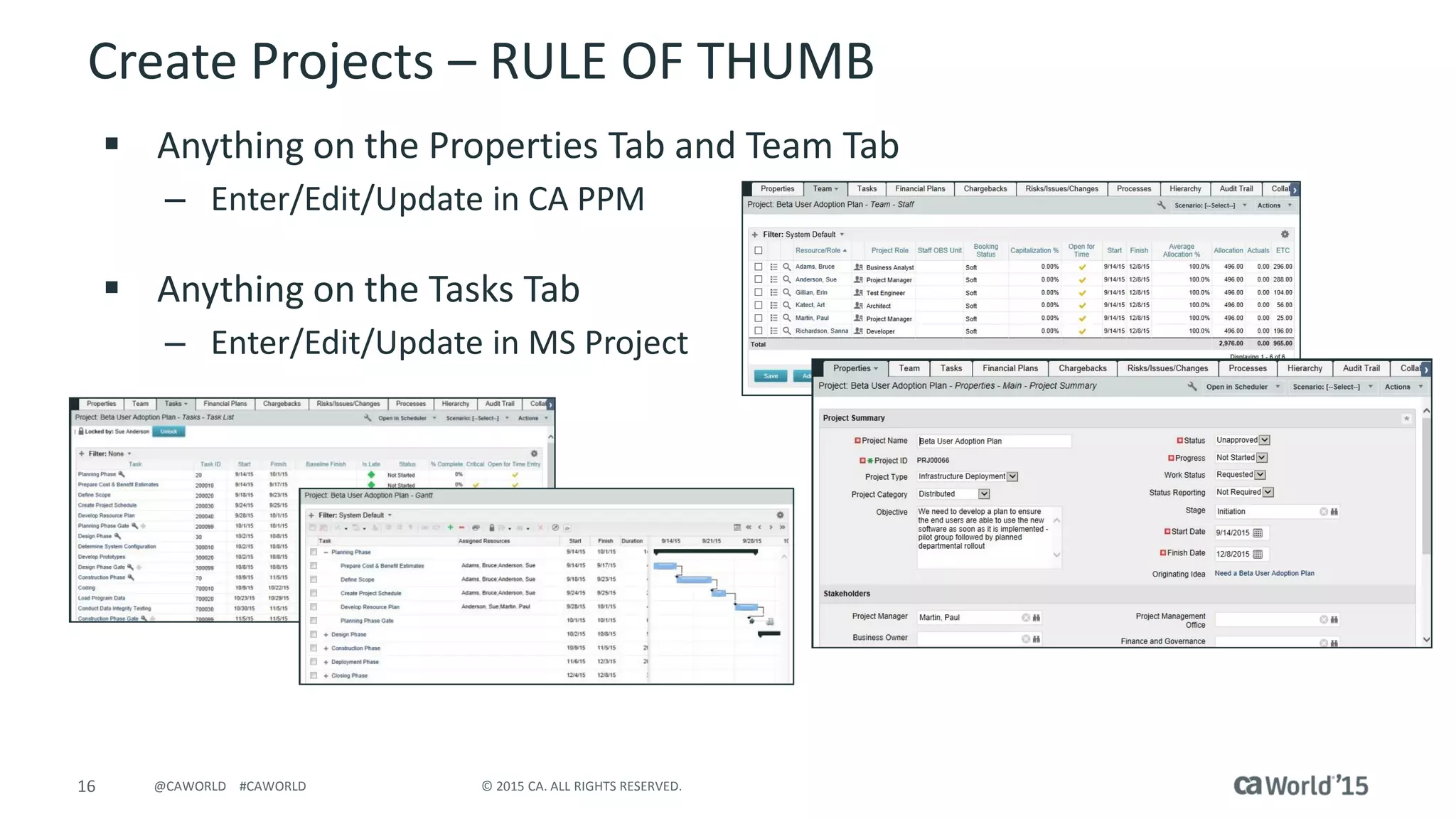

Create Projects – RULE OF THUMB
 Anything on the Properties Tab and Team Tab
– Enter/Edit/Update in CA PPM
 Anything on the Tasks Tab
– Enter/Edit/Update in MS Project
17 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Resources and MS Project
18 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

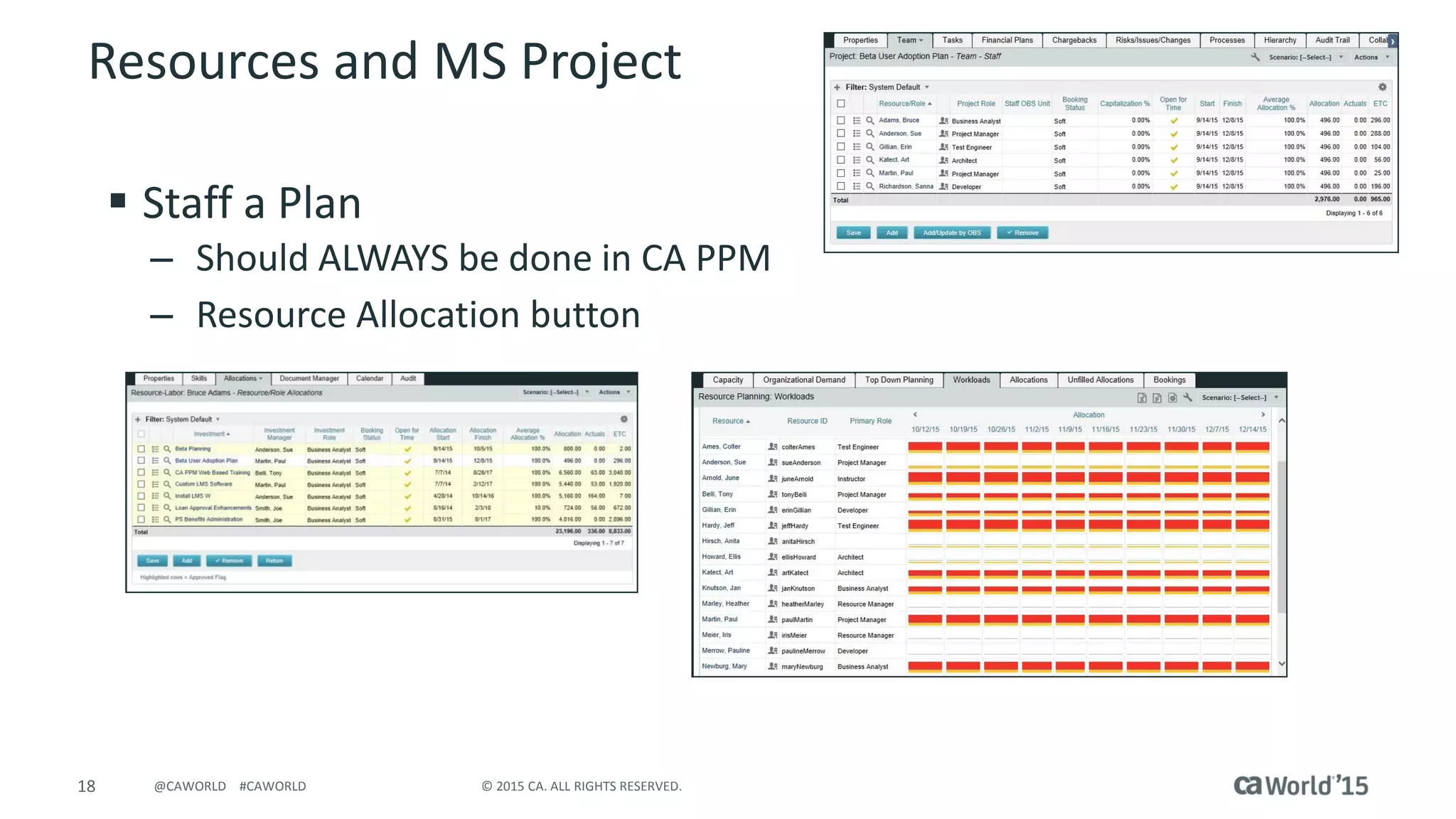

Resources and MS Project
 Staff a Plan
– Should ALWAYS be done in CA PPM
– Resource Allocation button
19 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

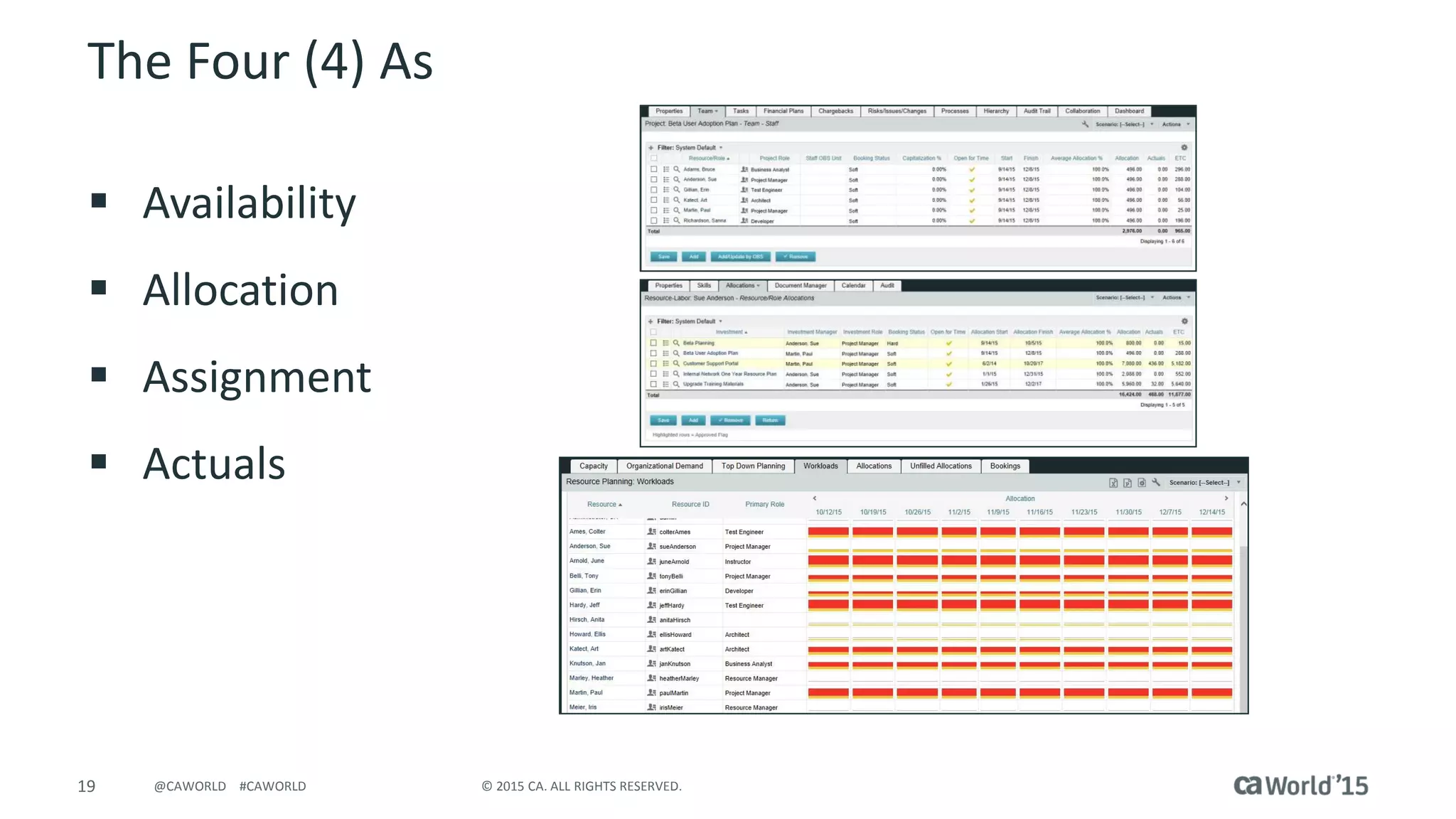

The Four (4) As
 Availability
 Allocation
 Assignment
 Actuals
20 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Work Breakdown Structure
There are often misunderstandings about the meanings of the
terms “duration” and “work”
A task has duration amount and work amount, which
may not always be equivalent values
21 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Define Work, Units and Duration

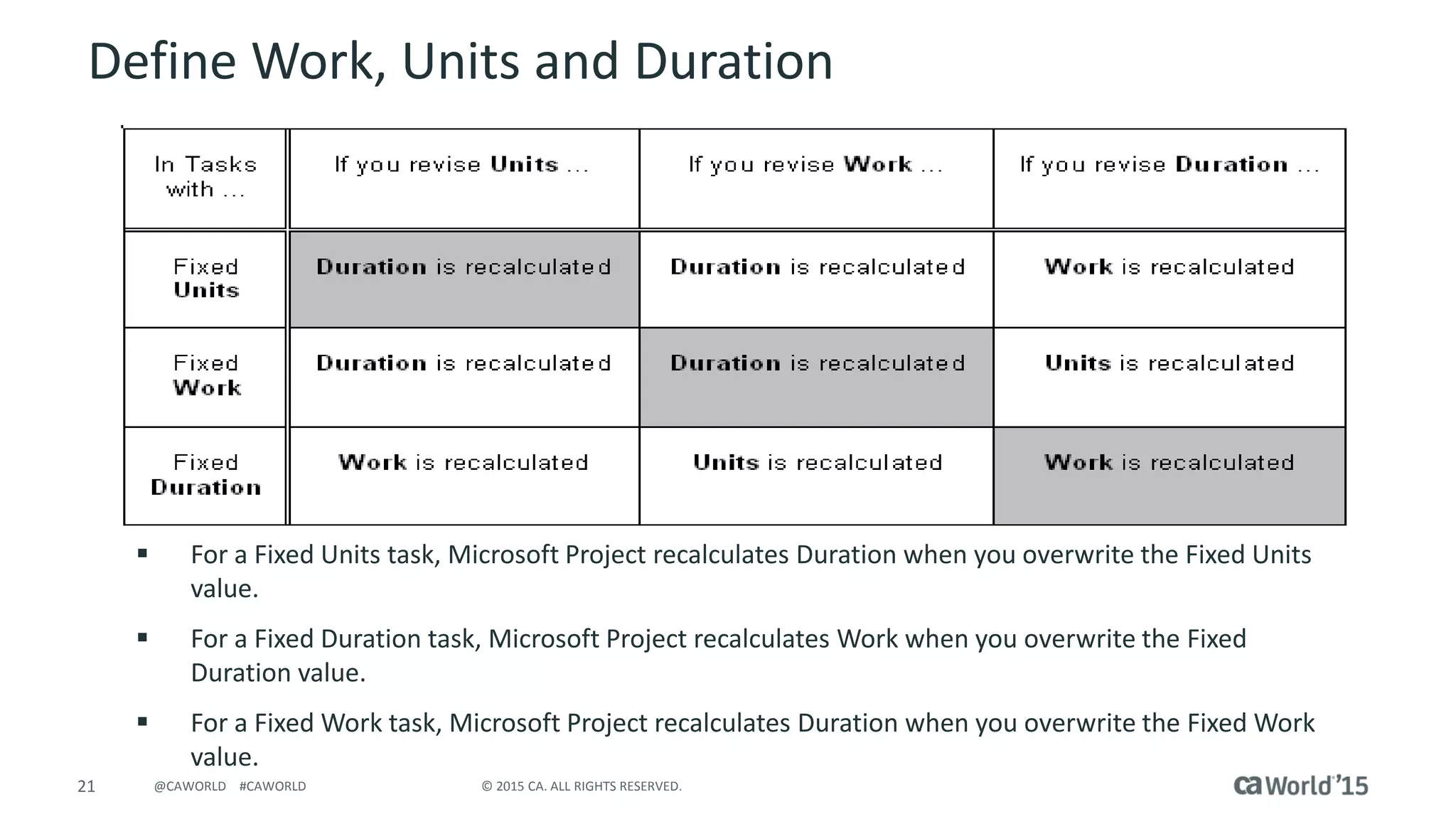

 For a Fixed Units task, Microsoft Project recalculates Duration when you overwrite the Fixed Units
value.
 For a Fixed Duration task, Microsoft Project recalculates Work when you overwrite the Fixed
Duration value.
 For a Fixed Work task, Microsoft Project recalculates Duration when you overwrite the Fixed Work
value.
22 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

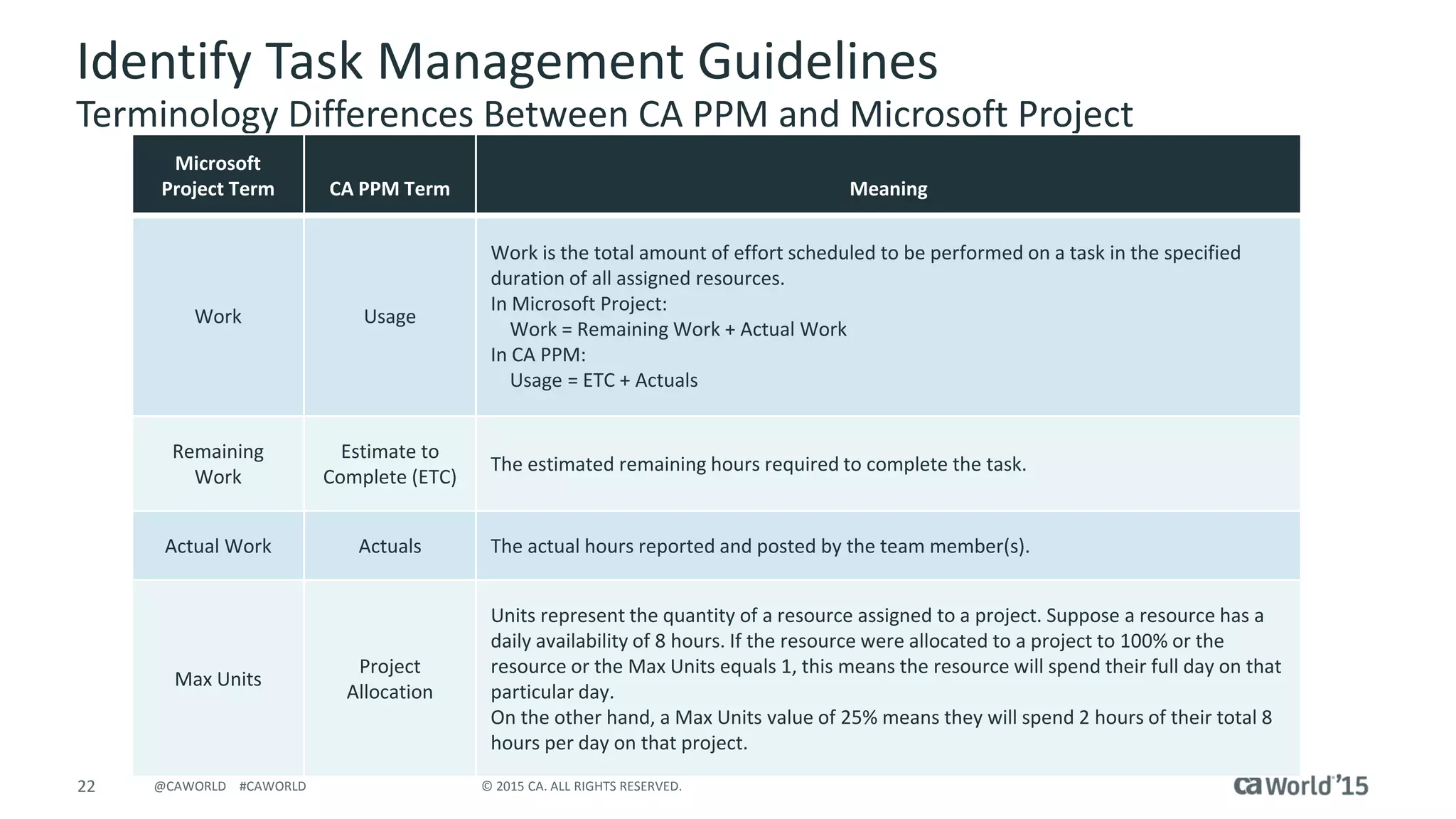

Identify Task Management Guidelines
Terminology Differences Between CA PPM and Microsoft Project
Microsoft
Project Term CA PPM Term Meaning
Work Usage
Work is the total amount of effort scheduled to be performed on a task in the specified
duration of all assigned resources.
In Microsoft Project:
Work = Remaining Work + Actual Work
In CA PPM:
Usage = ETC + Actuals
Remaining
Work
Estimate to
Complete (ETC)
The estimated remaining hours required to complete the task.
Actual Work Actuals The actual hours reported and posted by the team member(s).
Max Units
Project
Allocation
Units represent the quantity of a resource assigned to a project. Suppose a resource has a
daily availability of 8 hours. If the resource were allocated to a project to 100% or the
resource or the Max Units equals 1, this means the resource will spend their full day on that
particular day.
On the other hand, a Max Units value of 25% means they will spend 2 hours of their total 8
hours per day on that project.
23 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Identify Task Management Guidelines
Terminology Differences Between CA PPM and Microsoft Project Continued
Microsoft
Project Term CA PPM Term Meaning
Units
Task
Assignment
This is a subset of Max Units. Units represent the quantity of a resource assigned to a task.
Duration Duration
CA PPM Definition: The number of business days as inclusive of the Start Date and Finish
Date regardless of whether a split may/may not be located during the task.
Microsoft Project Definition: Calculates the duration of a task by counting the amount of
active working time between the scheduled start and end of the task. This is generally the
time from task start to finish, not counting time between split tasks.
% Complete % Complete % Complete is a manually entered field in both applications.

24 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

Identify Task Management Guidelines
Terminology Differences Between CA PPM and Microsoft Project Continued
Microsoft
Project Term CA PPM Term Meaning
% Work
Complete
% Expended
These are calculated fields.
CA PPM defines this as: Actuals / Usage.
Microsoft Project defines this as: Actuals / Total Work.
Type
(Task Level)
Variable
(Resource
Availability
driven)
Fixed
Duration
Boolean:
Checked or
Uncheked
The available Type options in Microsoft Project are Fixed Work, Fixed Units, and Fixed
Duration. Keep in mind the Microsoft Project equation: Work = Units * Duration.
In CA PPM, checking the Fixed Duration box prevents the task duration from being changed
by CA PPM regardless of the amount of work on the task.
Split Task Split Task
In CA PPM it’s the same term but a different approach to creating the split.
In Microsoft Project, adding splits to a task does not change the Duration, but will change
the Elapsed Duration.
25 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

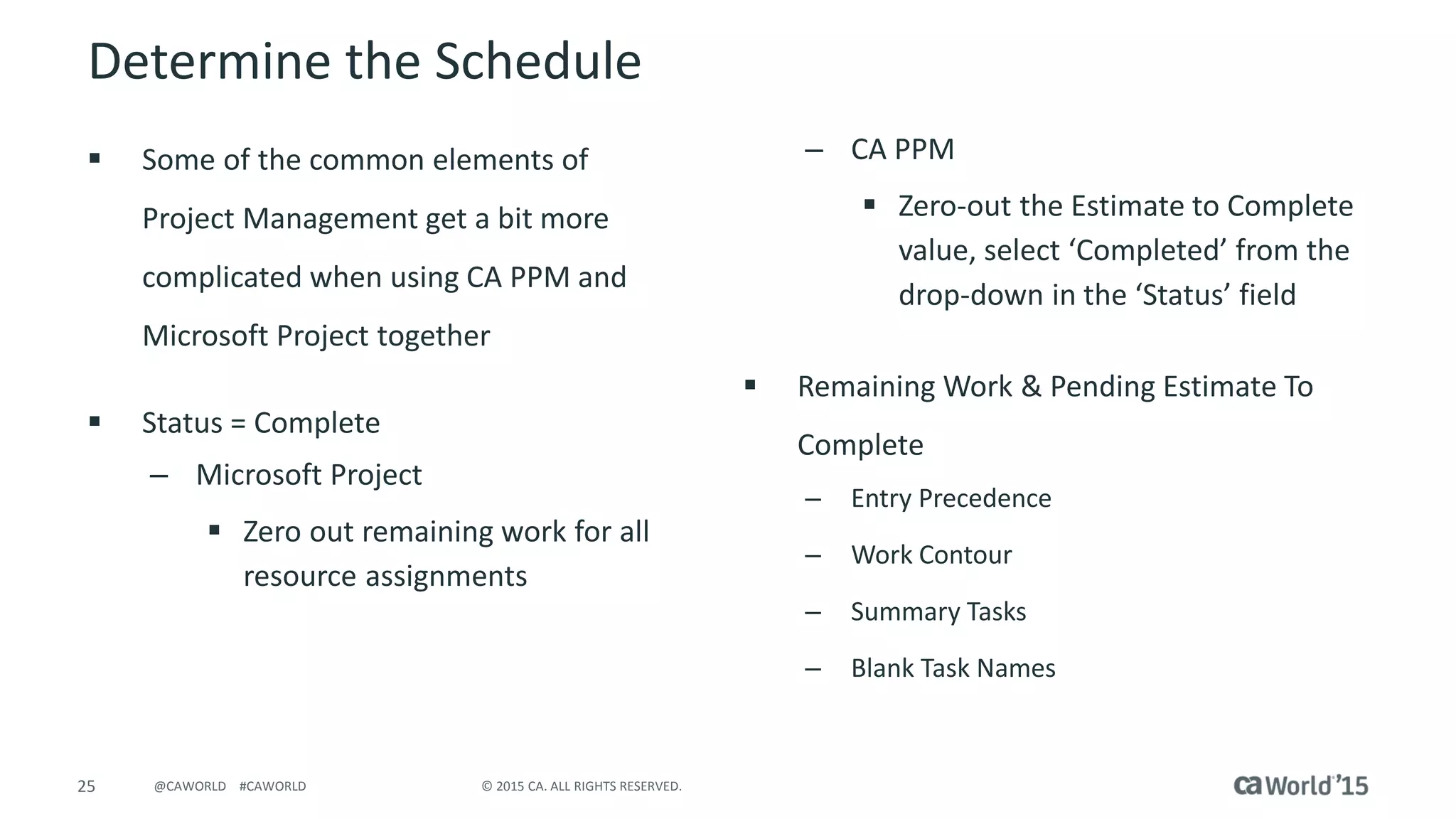

Determine the Schedule
 Some of the common elements of
Project Management get a bit more
complicated when using CA PPM and
Microsoft Project together
 Status = Complete
– Microsoft Project
 Zero out remaining work for all
resource assignments
– CA PPM
 Zero-out the Estimate to Complete
value, select ‘Completed’ from the
drop-down in the ‘Status’ field
 Remaining Work & Pending Estimate To
Complete
– Entry Precedence
– Work Contour
– Summary Tasks
– Blank Task Names
26 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Control the Project
27 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

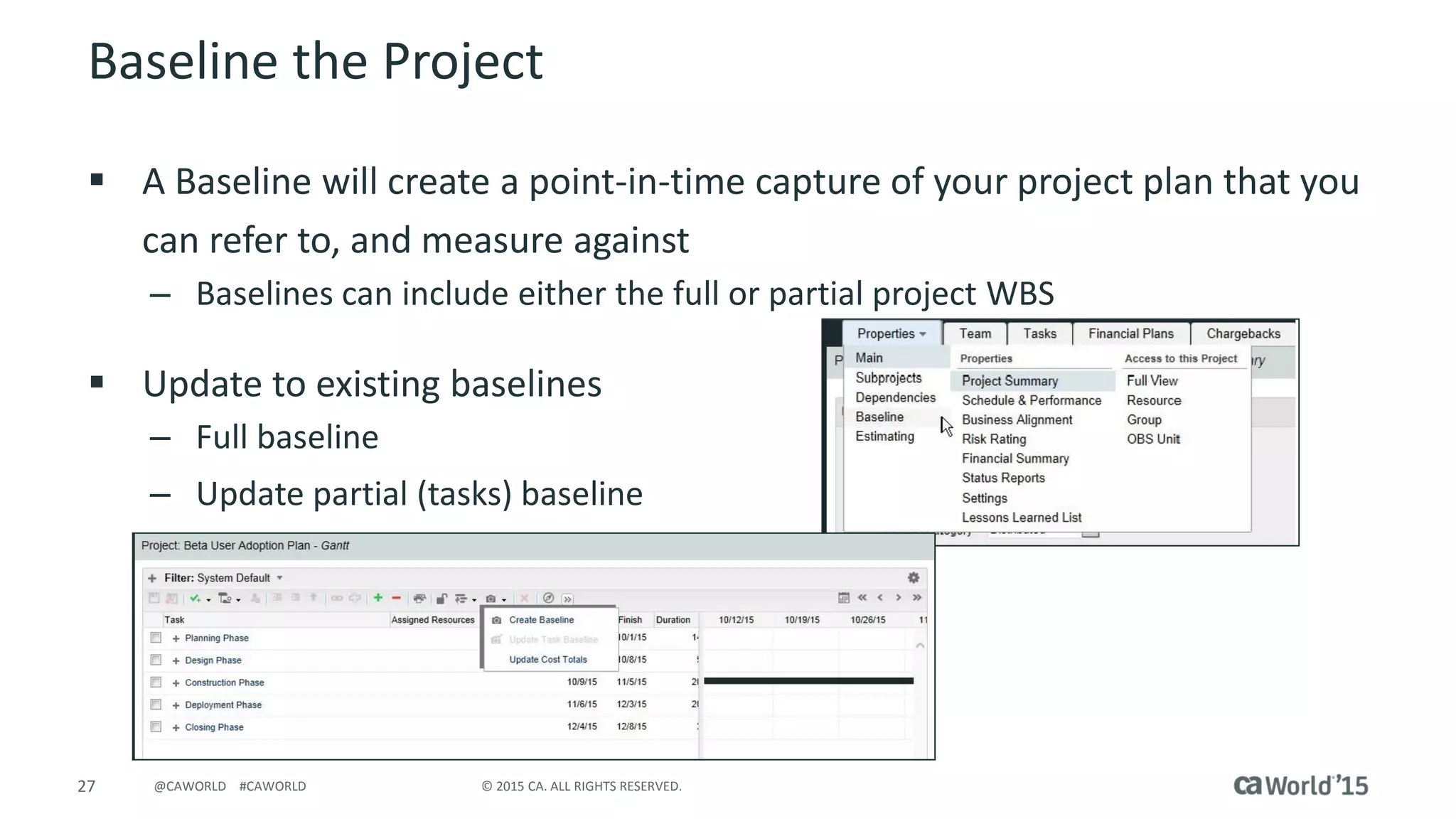

Baseline the Project
 A Baseline will create a point-in-time capture of your project plan that you
can refer to, and measure against
– Baselines can include either the full or partial project WBS
 Update to existing baselines
– Full baseline
– Update partial (tasks) baseline
28 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

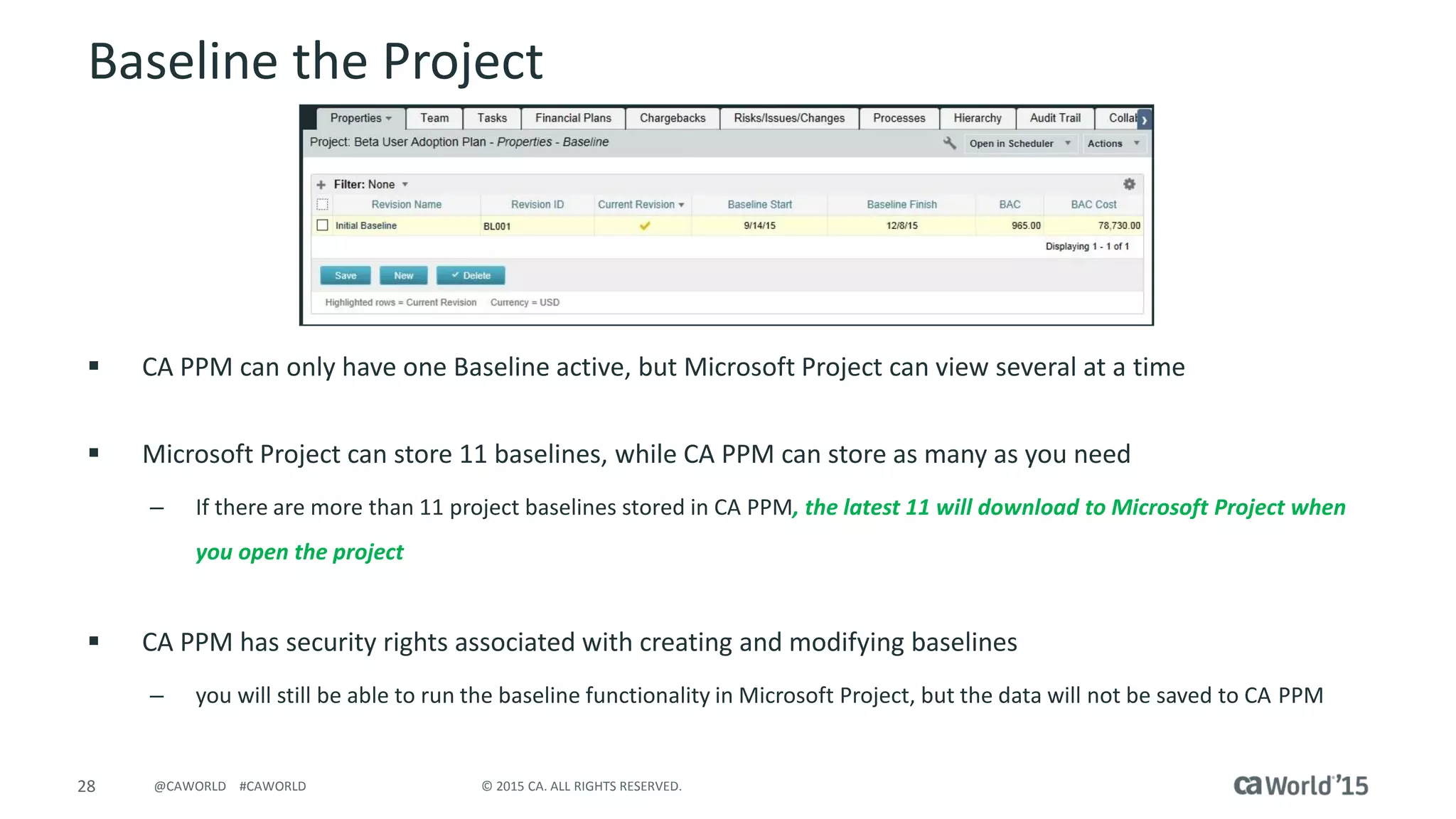

Baseline the Project
 CA PPM can only have one Baseline active, but Microsoft Project can view several at a time
 Microsoft Project can store 11 baselines, while CA PPM can store as many as you need
– If there are more than 11 project baselines stored in CA PPM, the latest 11 will download to Microsoft Project when
you open the project
 CA PPM has security rights associated with creating and modifying baselines
– you will still be able to run the baseline functionality in Microsoft Project, but the data will not be saved to CA PPM
29 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

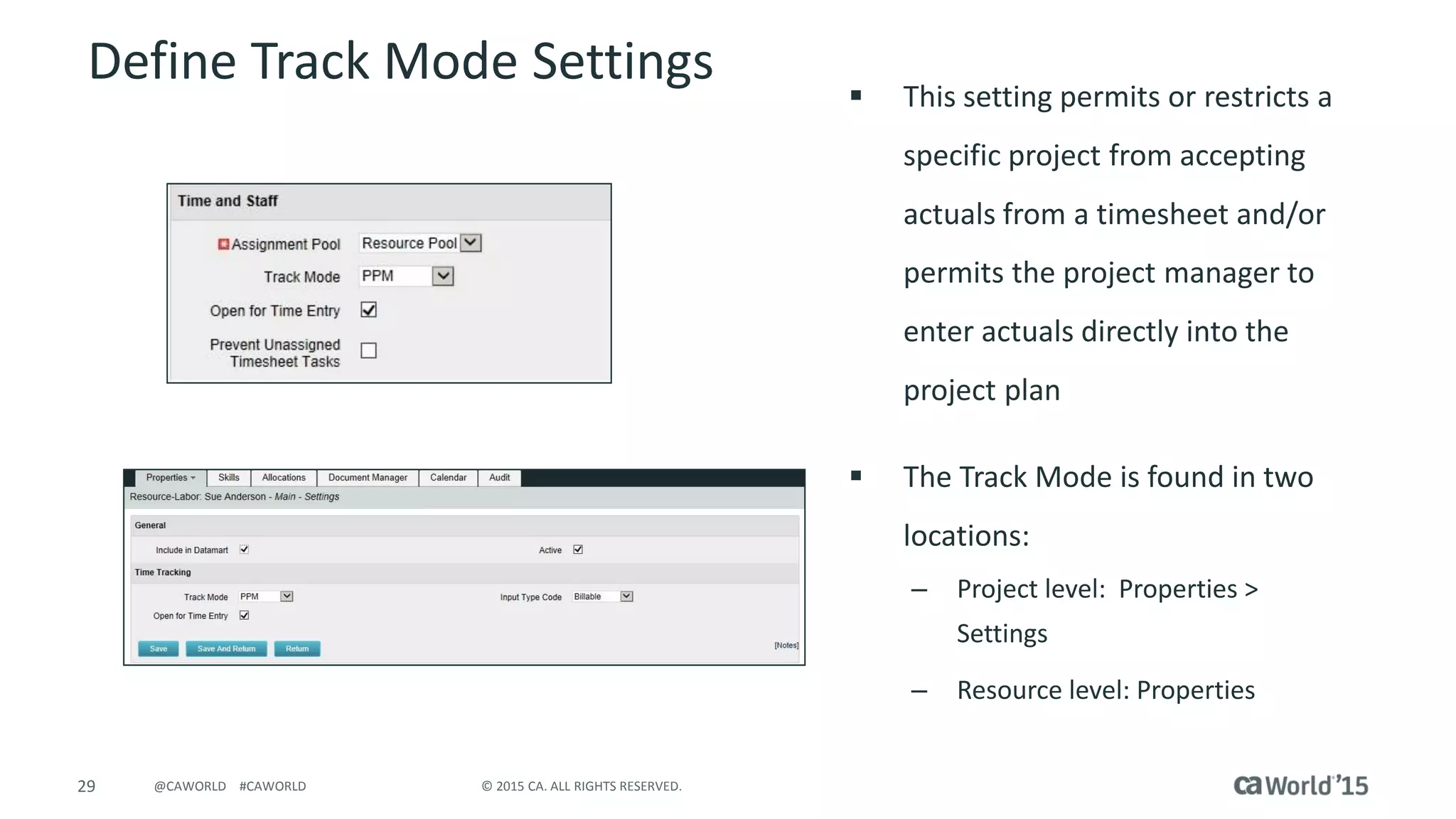

Define Track Mode Settings  This setting permits or restricts a
specific project from accepting
actuals from a timesheet and/or
permits the project manager to
enter actuals directly into the
project plan
 The Track Mode is found in two
locations:
– Project level: Properties >
Settings
– Resource level: Properties
30 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

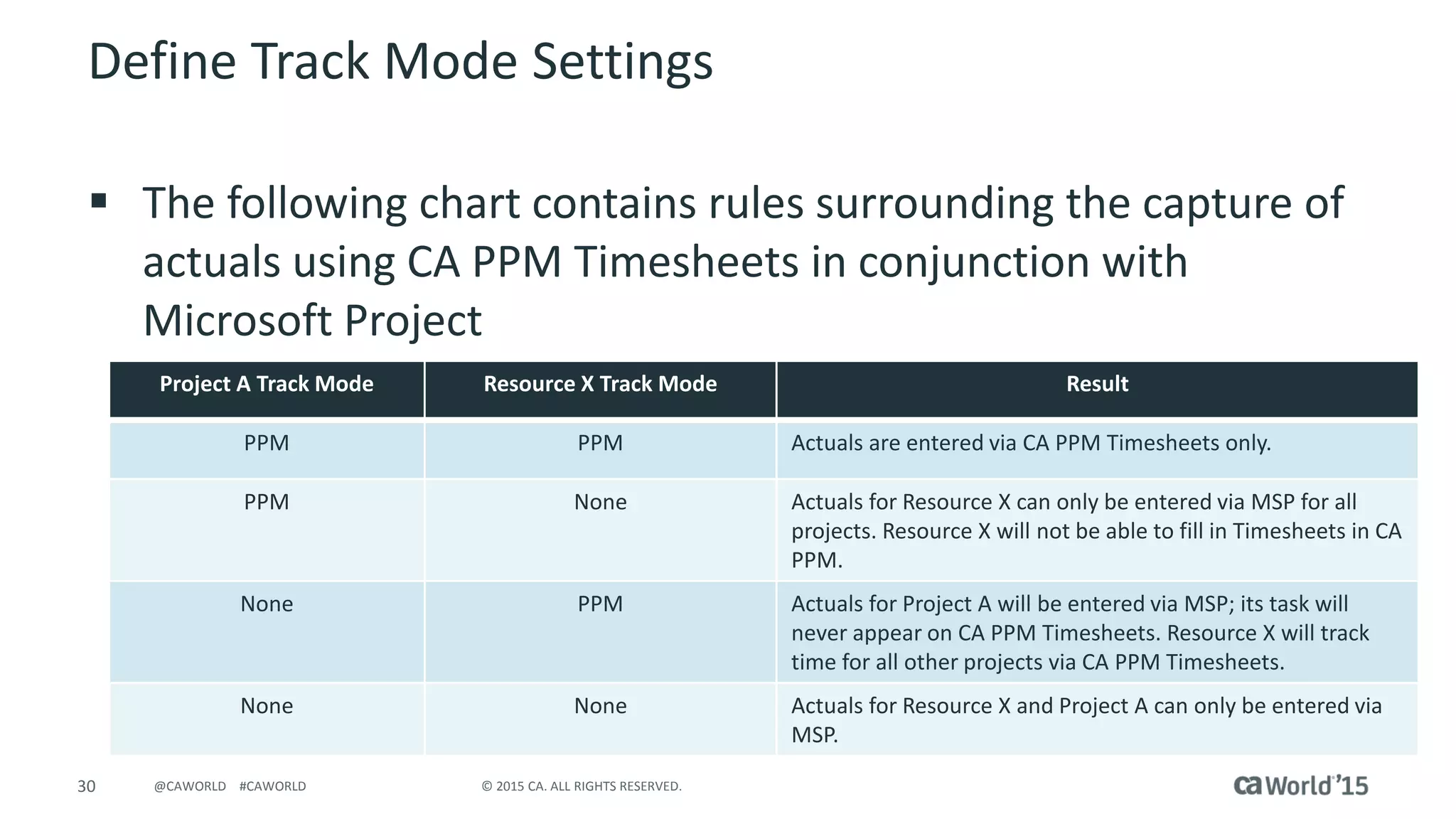

Define Track Mode Settings
 The following chart contains rules surrounding the capture of
actuals using CA PPM Timesheets in conjunction with
Microsoft Project
Project A Track Mode Resource X Track Mode Result
PPM PPM Actuals are entered via CA PPM Timesheets only.
PPM None Actuals for Resource X can only be entered via MSP for all
projects. Resource X will not be able to fill in Timesheets in CA
PPM.
None PPM Actuals for Project A will be entered via MSP; its task will
never appear on CA PPM Timesheets. Resource X will track
time for all other projects via CA PPM Timesheets.
None None Actuals for Resource X and Project A can only be entered via
MSP.
31 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

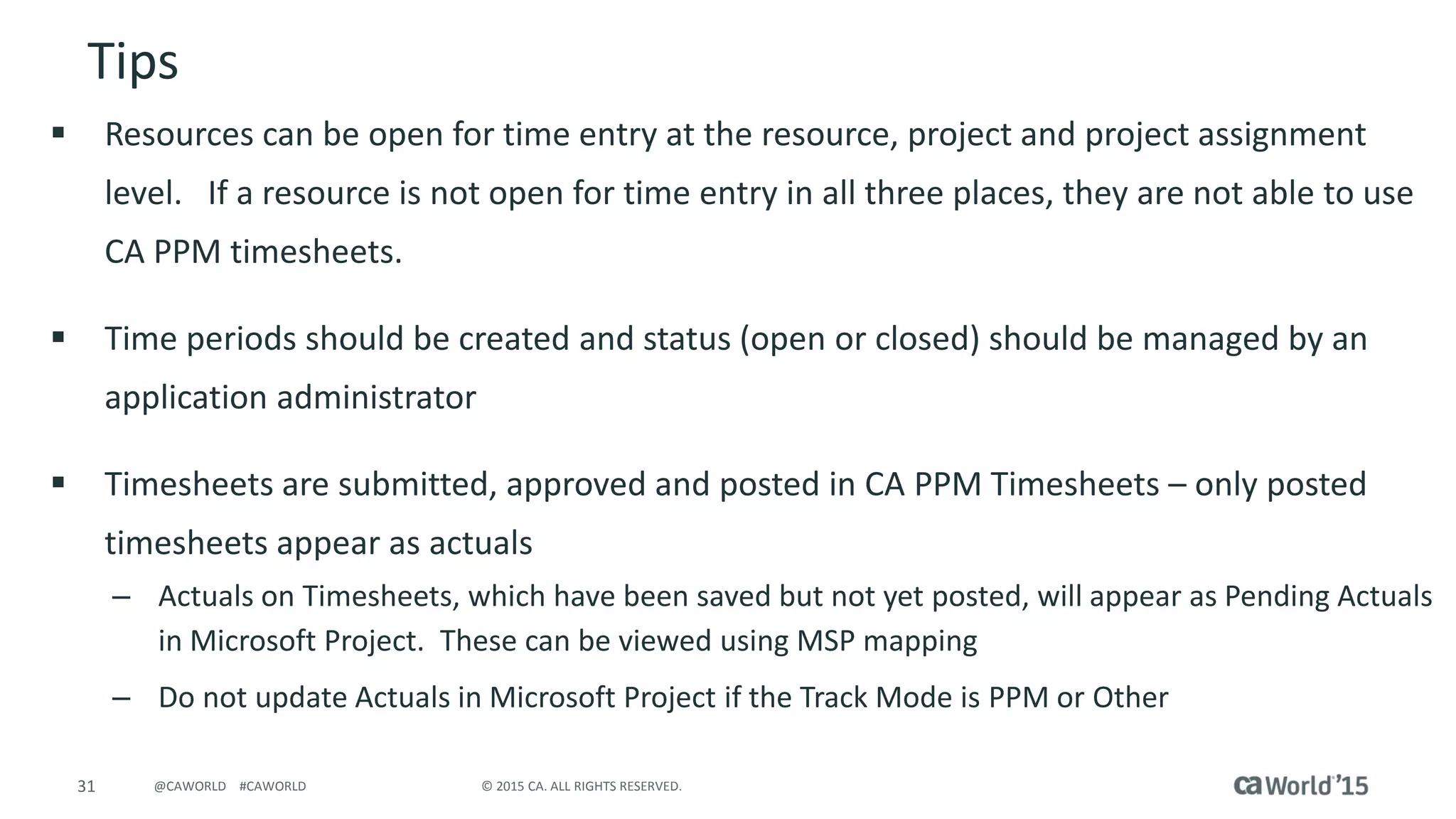

Tips
 Resources can be open for time entry at the resource, project and project assignment
level. If a resource is not open for time entry in all three places, they are not able to use
CA PPM timesheets.
 Time periods should be created and status (open or closed) should be managed by an
application administrator
 Timesheets are submitted, approved and posted in CA PPM Timesheets – only posted
timesheets appear as actuals
– Actuals on Timesheets, which have been saved but not yet posted, will appear as Pending Actuals
in Microsoft Project. These can be viewed using MSP mapping
– Do not update Actuals in Microsoft Project if the Track Mode is PPM or Other
32 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

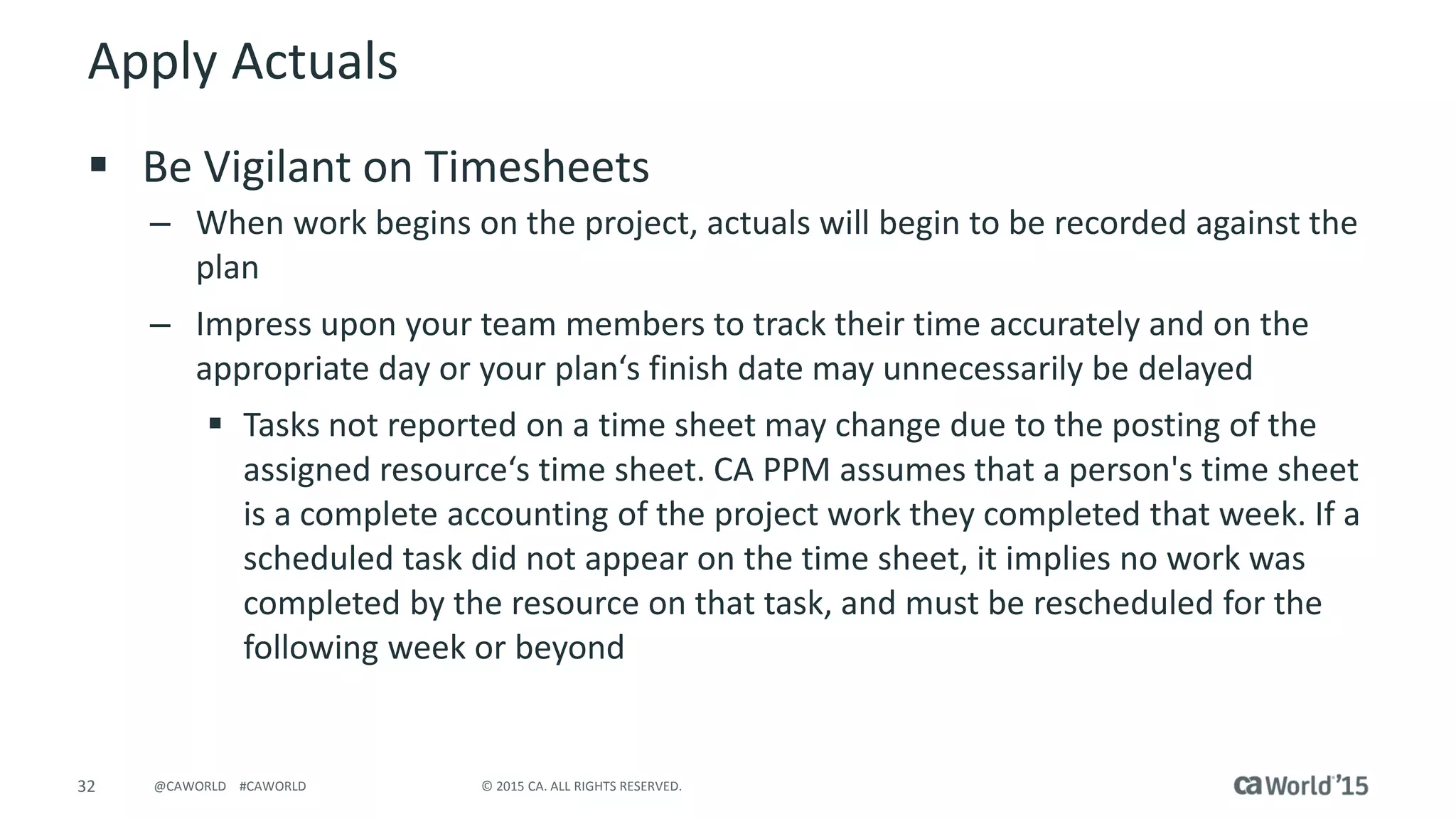

Apply Actuals
 Be Vigilant on Timesheets
– When work begins on the project, actuals will begin to be recorded against the
plan
– Impress upon your team members to track their time accurately and on the
appropriate day or your plan‘s finish date may unnecessarily be delayed
 Tasks not reported on a time sheet may change due to the posting of the
assigned resource‘s time sheet. CA PPM assumes that a person's time sheet
is a complete accounting of the project work they completed that week. If a
scheduled task did not appear on the time sheet, it implies no work was
completed by the resource on that task, and must be rescheduled for the
following week or beyond
33 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

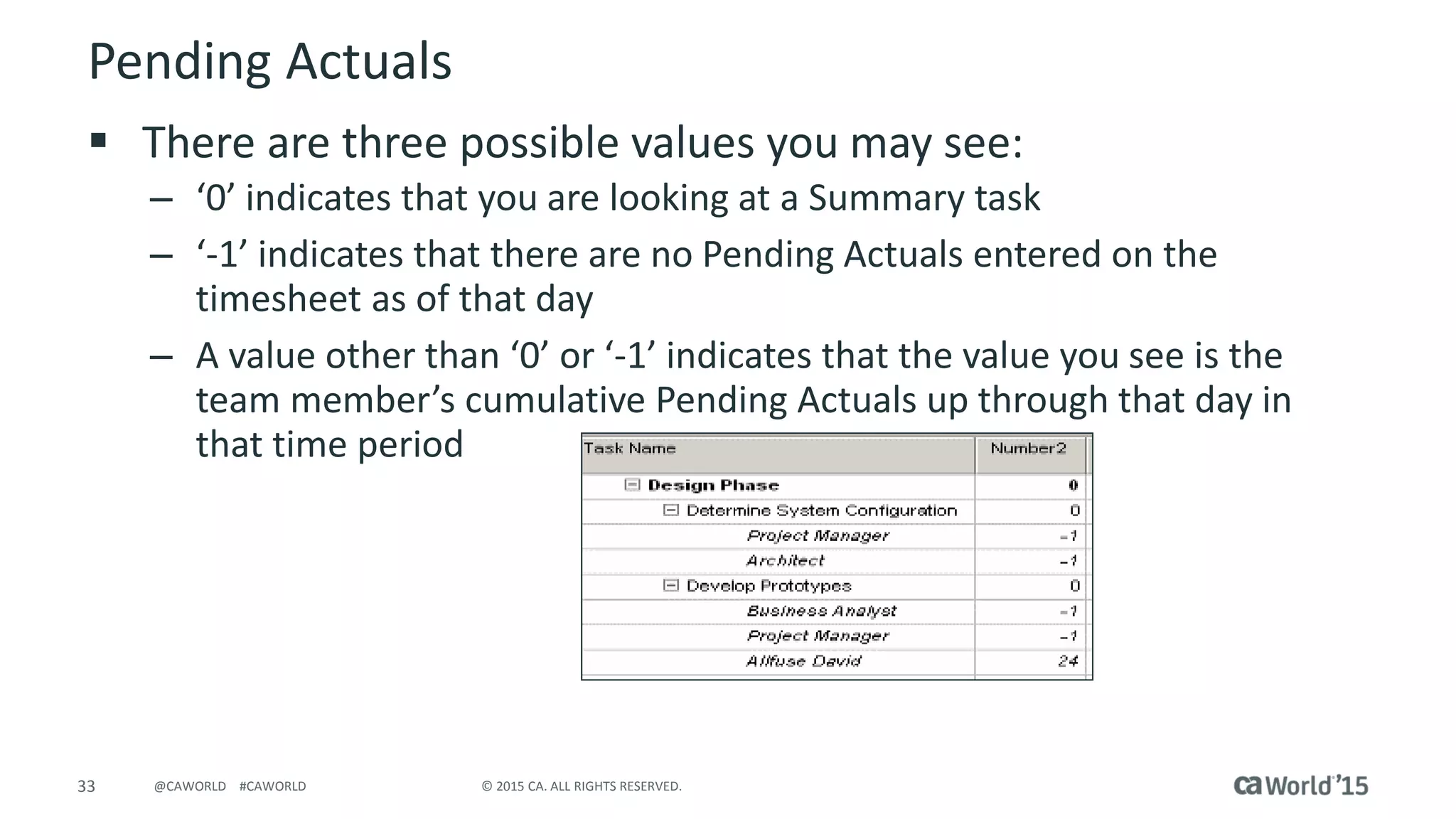

Pending Actuals
 There are three possible values you may see:
– ‘0’ indicates that you are looking at a Summary task
– ‘-1’ indicates that there are no Pending Actuals entered on the
timesheet as of that day
– A value other than ‘0’ or ‘-1’ indicates that the value you see is the
team member’s cumulative Pending Actuals up through that day in
that time period
34 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD

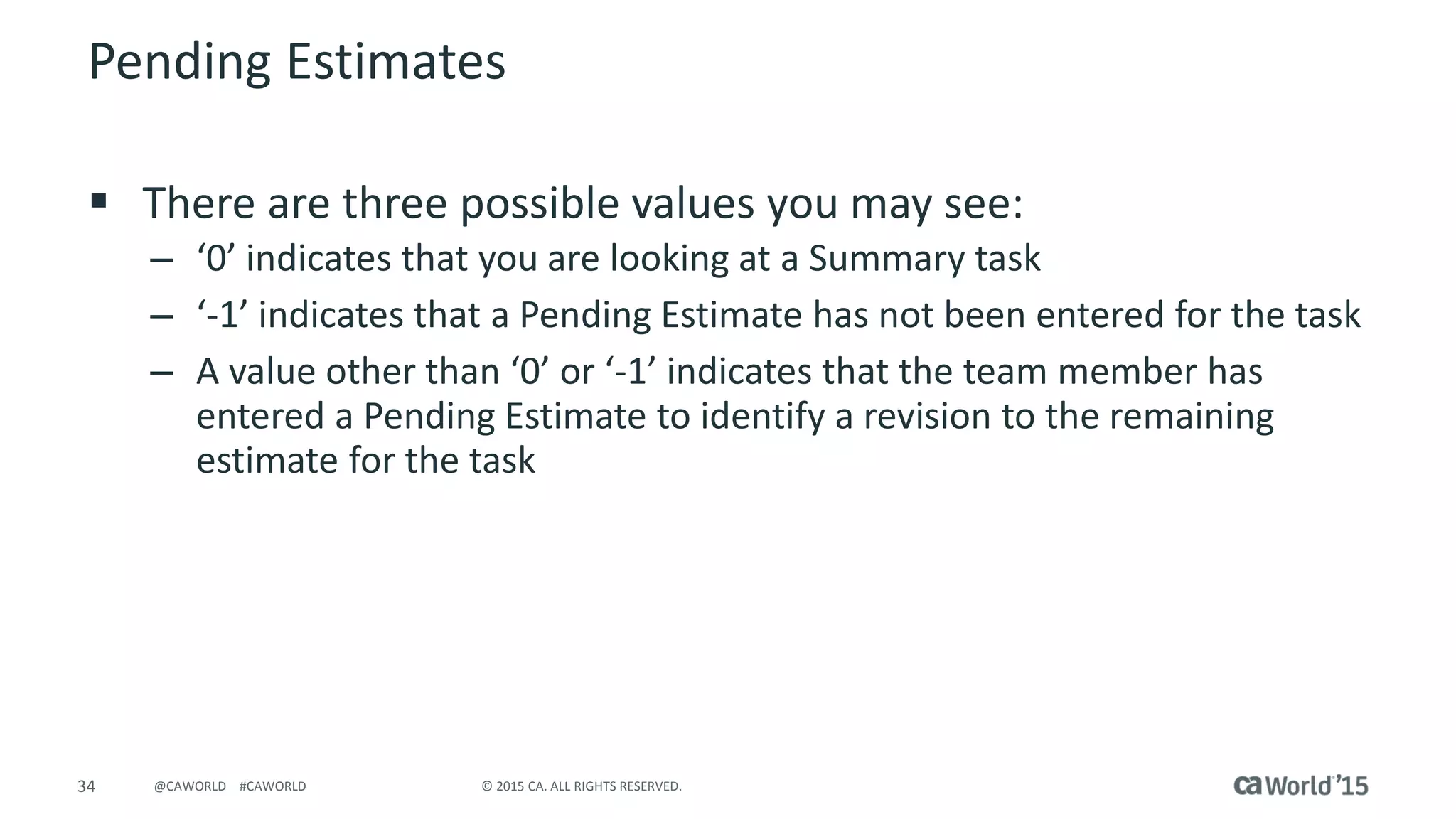

Pending Estimates
 There are three possible values you may see:
– ‘0’ indicates that you are looking at a Summary task
– ‘-1’ indicates that a Pending Estimate has not been entered for the task
– A value other than ‘0’ or ‘-1’ indicates that the team member has
entered a Pending Estimate to identify a revision to the remaining
estimate for the task
35 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
Q & A
36 © 2015 CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD
For More Information
To learn more, please visit:
http://cainc.to/Nv2VOe
CA World ’15

CA Project and Portfolio Management v14.x: MS Project Integration: Tips, Tricks and What's New for You

  • 1.
    Pre-Con Education: CAProject and Portfolio Management v14.x MS Project Integration Tips, Tricks and What’s New for You Kismet Silva-Smith Agile Management CA Technologies Instructor AMX05E @TwitterHandle #CAWorld
  • 2.
    2 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD For Informational Purposes Only Terms of this Presentation © 2015 CA. All rights reserved. All trademarks referenced herein belong to their respective companies. The presentation provided at CA World 2015 is intended for information purposes only and does not form any type of warranty. Some of the specific slides with customer references relate to customer's specific use and experience of CA products and solutions so actual results may vary. Certain information in this presentation may outline CA’s general product direction. This presentation shall not serve to (i) affect the rights and/or obligations of CA or its licensees under any existing or future license agreement or services agreement relating to any CA software product; or (ii) amend any product documentation or specifications for any CA software product. This presentation is based on current information and resource allocations as of November 18, 2015, and is subject to change or withdrawal by CA at any time without notice. The development, release and timing of any features or functionality described in this presentation remain at CA’s sole discretion. Notwithstanding anything in this presentation to the contrary, upon the general availability of any future CA product release referenced in this presentation, CA may make such release available to new licensees in the form of a regularly scheduled major product release. Such release may be made available to licensees of the product who are active subscribers to CA maintenance and support, on a when and if- available basis. The information in this presentation is not deemed to be incorporated into any contract.
  • 3.
    3 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Abstract The session will show you where and how Microsoft Project and CA Project and Portfolio Management (CA PPM) bi-directionally map data, how to create and manage tasks, assignments and scheduling, as well as updating task status and work. It includes a broad discussion where and when data should be entered in CA PPM and MS Project, on defining data elements and how to capture them. Kismet Silva-Smith CA Technologies Instructor
  • 4.
    4 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Results MS Project and CA PPM bi-directionally maps data, manages tasks, assignments and scheduling as well as updating task status. The CA PPM project acts as the ‘umbrella’ for PM methodology . The result is a project that follows Project Management and Scheduling standards. Summary MS Project Integration with CA PPM
  • 5.
    5 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Agenda INTEGRATION OVERVIEW CUSTOM VIEWS AND CREATING A PROJECT Q AND A RESOURCES AND MS PROJECT WORK BREAKDOWN STRUCTURE CONTROL THE PROJECT 1 2 3 4 5 6
  • 6.
    6 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Integration Overview
  • 7.
    7 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify the MS Project Integration 2 Lines Max  Microsoft® Project Interface – Schedule Connect  Project Properties – Settings Page  Set Scheduler to Microsoft Project PICK ONE AND STICK WITH IT PER PROJECT
  • 8.
    8 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify and Install the MSP Interface
  • 9.
    9 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Bi-Directional  New xml file – same location as the .mpp file  Usually in the My Documents folder  Supportable – old integration no longer supported by Microsoft  When you launch a plan from the CA PPM screen, it exports this plan to your local client system.  After you complete updating your session from within Microsoft Project, you will select Save from the CA PPM Integration toolbar to retain your updates
  • 10.
    10 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Install the MSP Interface Tips
  • 11.
    11 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Set Defaults and Options
  • 12.
    12 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Set Defaults and OptionsContinued  Tips – At a minimum, you must set the File – Project Option defaults at the application level – Additionally, you will want to check and modify these settings on the individual projects that were created before you adjusted these File – Project Option defaults – These projects would have inherited the former default settings – Application Level Defaults allow all new projects to inherit the default settings. – Setting should also be reset for Legacy projects that are being brought into CA PPM
  • 13.
    13 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify Field Mappings
  • 14.
    14 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Custom Views and Creating a Project
  • 15.
    15 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Custom Views  Gantt Chart View ̶ Add the Key Task Column ̶ Add the Charge Code Column – Only if you let Users select  Task Usage View ̶ actual work ̶ remaining  Custom View ̶ Combined View  Gantt Chart on the top  Task Usage on bottom Modify Existing Views to Create Custom Views
  • 16.
    16 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Create Projects – RULE OF THUMB  Anything on the Properties Tab and Team Tab – Enter/Edit/Update in CA PPM  Anything on the Tasks Tab – Enter/Edit/Update in MS Project
  • 17.
    17 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Resources and MS Project
  • 18.
    18 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Resources and MS Project  Staff a Plan – Should ALWAYS be done in CA PPM – Resource Allocation button
  • 19.
    19 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD The Four (4) As  Availability  Allocation  Assignment  Actuals
  • 20.
    20 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Work Breakdown Structure There are often misunderstandings about the meanings of the terms “duration” and “work” A task has duration amount and work amount, which may not always be equivalent values
  • 21.
    21 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Define Work, Units and Duration  For a Fixed Units task, Microsoft Project recalculates Duration when you overwrite the Fixed Units value.  For a Fixed Duration task, Microsoft Project recalculates Work when you overwrite the Fixed Duration value.  For a Fixed Work task, Microsoft Project recalculates Duration when you overwrite the Fixed Work value.
  • 22.
    22 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify Task Management Guidelines Terminology Differences Between CA PPM and Microsoft Project Microsoft Project Term CA PPM Term Meaning Work Usage Work is the total amount of effort scheduled to be performed on a task in the specified duration of all assigned resources. In Microsoft Project: Work = Remaining Work + Actual Work In CA PPM: Usage = ETC + Actuals Remaining Work Estimate to Complete (ETC) The estimated remaining hours required to complete the task. Actual Work Actuals The actual hours reported and posted by the team member(s). Max Units Project Allocation Units represent the quantity of a resource assigned to a project. Suppose a resource has a daily availability of 8 hours. If the resource were allocated to a project to 100% or the resource or the Max Units equals 1, this means the resource will spend their full day on that particular day. On the other hand, a Max Units value of 25% means they will spend 2 hours of their total 8 hours per day on that project.
  • 23.
    23 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify Task Management Guidelines Terminology Differences Between CA PPM and Microsoft Project Continued Microsoft Project Term CA PPM Term Meaning Units Task Assignment This is a subset of Max Units. Units represent the quantity of a resource assigned to a task. Duration Duration CA PPM Definition: The number of business days as inclusive of the Start Date and Finish Date regardless of whether a split may/may not be located during the task. Microsoft Project Definition: Calculates the duration of a task by counting the amount of active working time between the scheduled start and end of the task. This is generally the time from task start to finish, not counting time between split tasks. % Complete % Complete % Complete is a manually entered field in both applications.
  • 24.
    24 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Identify Task Management Guidelines Terminology Differences Between CA PPM and Microsoft Project Continued Microsoft Project Term CA PPM Term Meaning % Work Complete % Expended These are calculated fields. CA PPM defines this as: Actuals / Usage. Microsoft Project defines this as: Actuals / Total Work. Type (Task Level) Variable (Resource Availability driven) Fixed Duration Boolean: Checked or Uncheked The available Type options in Microsoft Project are Fixed Work, Fixed Units, and Fixed Duration. Keep in mind the Microsoft Project equation: Work = Units * Duration. In CA PPM, checking the Fixed Duration box prevents the task duration from being changed by CA PPM regardless of the amount of work on the task. Split Task Split Task In CA PPM it’s the same term but a different approach to creating the split. In Microsoft Project, adding splits to a task does not change the Duration, but will change the Elapsed Duration.
  • 25.
    25 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Determine the Schedule  Some of the common elements of Project Management get a bit more complicated when using CA PPM and Microsoft Project together  Status = Complete – Microsoft Project  Zero out remaining work for all resource assignments – CA PPM  Zero-out the Estimate to Complete value, select ‘Completed’ from the drop-down in the ‘Status’ field  Remaining Work & Pending Estimate To Complete – Entry Precedence – Work Contour – Summary Tasks – Blank Task Names
  • 26.
    26 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Control the Project
  • 27.
    27 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Baseline the Project  A Baseline will create a point-in-time capture of your project plan that you can refer to, and measure against – Baselines can include either the full or partial project WBS  Update to existing baselines – Full baseline – Update partial (tasks) baseline
  • 28.
    28 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Baseline the Project  CA PPM can only have one Baseline active, but Microsoft Project can view several at a time  Microsoft Project can store 11 baselines, while CA PPM can store as many as you need – If there are more than 11 project baselines stored in CA PPM, the latest 11 will download to Microsoft Project when you open the project  CA PPM has security rights associated with creating and modifying baselines – you will still be able to run the baseline functionality in Microsoft Project, but the data will not be saved to CA PPM
  • 29.
    29 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Define Track Mode Settings  This setting permits or restricts a specific project from accepting actuals from a timesheet and/or permits the project manager to enter actuals directly into the project plan  The Track Mode is found in two locations: – Project level: Properties > Settings – Resource level: Properties
  • 30.
    30 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Define Track Mode Settings  The following chart contains rules surrounding the capture of actuals using CA PPM Timesheets in conjunction with Microsoft Project Project A Track Mode Resource X Track Mode Result PPM PPM Actuals are entered via CA PPM Timesheets only. PPM None Actuals for Resource X can only be entered via MSP for all projects. Resource X will not be able to fill in Timesheets in CA PPM. None PPM Actuals for Project A will be entered via MSP; its task will never appear on CA PPM Timesheets. Resource X will track time for all other projects via CA PPM Timesheets. None None Actuals for Resource X and Project A can only be entered via MSP.
  • 31.
    31 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Tips  Resources can be open for time entry at the resource, project and project assignment level. If a resource is not open for time entry in all three places, they are not able to use CA PPM timesheets.  Time periods should be created and status (open or closed) should be managed by an application administrator  Timesheets are submitted, approved and posted in CA PPM Timesheets – only posted timesheets appear as actuals – Actuals on Timesheets, which have been saved but not yet posted, will appear as Pending Actuals in Microsoft Project. These can be viewed using MSP mapping – Do not update Actuals in Microsoft Project if the Track Mode is PPM or Other
  • 32.
    32 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Apply Actuals  Be Vigilant on Timesheets – When work begins on the project, actuals will begin to be recorded against the plan – Impress upon your team members to track their time accurately and on the appropriate day or your plan‘s finish date may unnecessarily be delayed  Tasks not reported on a time sheet may change due to the posting of the assigned resource‘s time sheet. CA PPM assumes that a person's time sheet is a complete accounting of the project work they completed that week. If a scheduled task did not appear on the time sheet, it implies no work was completed by the resource on that task, and must be rescheduled for the following week or beyond
  • 33.
    33 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Pending Actuals  There are three possible values you may see: – ‘0’ indicates that you are looking at a Summary task – ‘-1’ indicates that there are no Pending Actuals entered on the timesheet as of that day – A value other than ‘0’ or ‘-1’ indicates that the value you see is the team member’s cumulative Pending Actuals up through that day in that time period
  • 34.
    34 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Pending Estimates  There are three possible values you may see: – ‘0’ indicates that you are looking at a Summary task – ‘-1’ indicates that a Pending Estimate has not been entered for the task – A value other than ‘0’ or ‘-1’ indicates that the team member has entered a Pending Estimate to identify a revision to the remaining estimate for the task
  • 35.
    35 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD Q & A
  • 36.
    36 © 2015CA. ALL RIGHTS RESERVED.@CAWORLD #CAWORLD For More Information To learn more, please visit: http://cainc.to/Nv2VOe CA World ’15
