w w w . n a p a . f i
Journey From Project Organization to
a SAFe Company
Toivo Vaje
@ToivoVaje
Manager, Software Releases
NAPA Technology
#NAPA
#SAFe
w w w . n a p a . f i

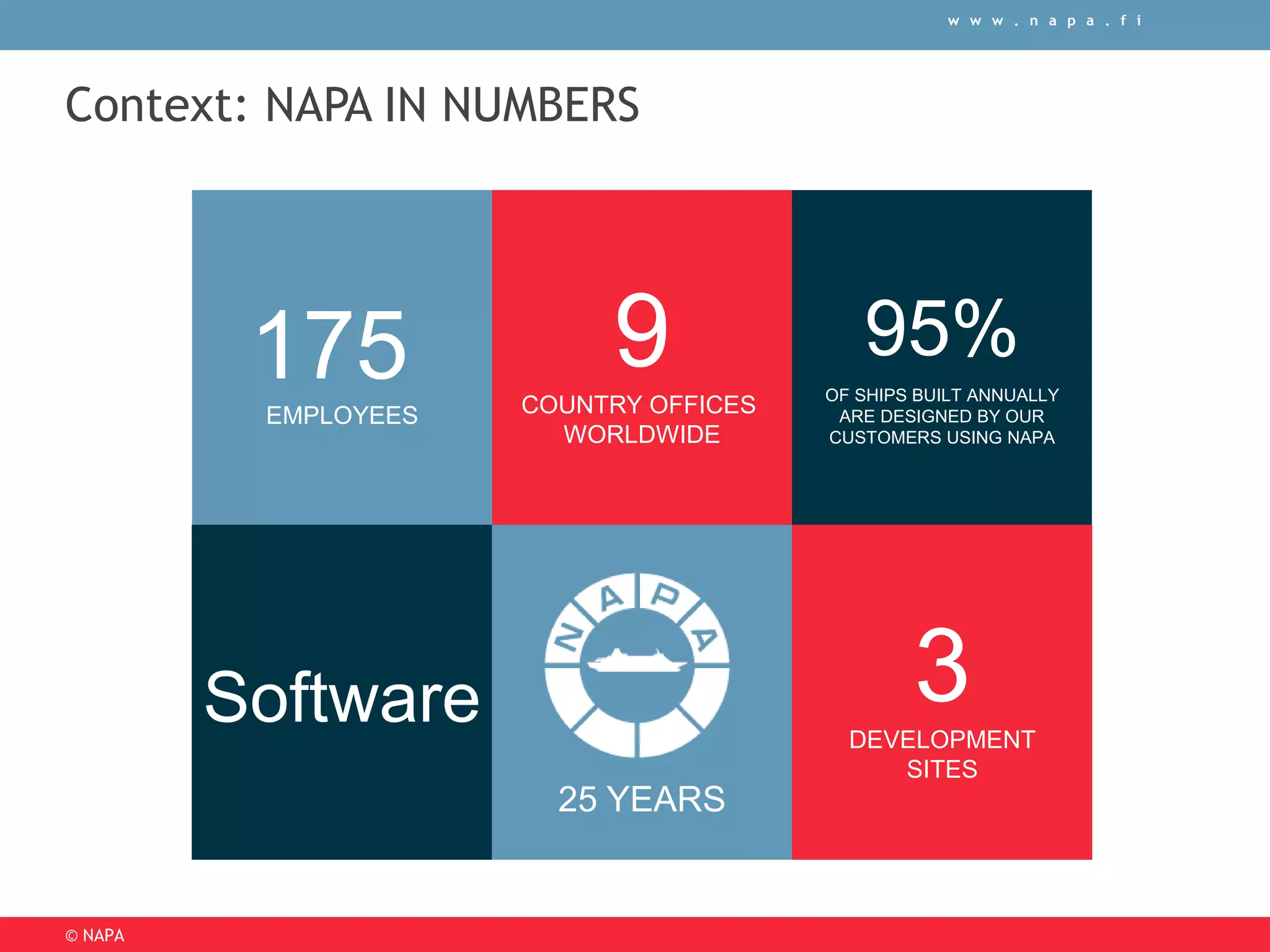

Context: NAPA IN NUMBERS
95%
OF SHIPS BUILT ANNUALLY
ARE DESIGNED BY OUR
CUSTOMERS USING NAPA
9COUNTRY OFFICES
WORLDWIDE
175EMPLOYEES
© NAPA
25 YEARS
Software 3DEVELOPMENT
SITES
w w w . n a p a . f i
Me
• Master of Science (Physics)
• 7+ years in Software Development
• Developer,
Scrum Master,
Coach,
Process Owner,
Value Chain Owner,
Manager
• Jack of All Trades
• Optimize the whole
• @ToivoVaje
Contents
History -2012
Organizational change 2012
Release Planning Days 2014-
Taking the Market
Beginning 1989
Organic Growth
http://www.napa.fi/About-NAPA/Background
Annual major releases
Projects (a lot of)
Variable scope and schedule
Growth Pain
Contents
History -2012
Organizational change 2012
Release Planning Days 2014-
Structure and Processes
NAPA Technology 2/2012
Finland
India
Romania
Software
Development
Process
nn
Release
Team
nn
Platform &
Architecture
nn
Log / Voyage
Nn
Nn
Nn
Nn
Nn
Ship
Model
Nn
Nn
Nn
Nn
Nn
Nn
Statutory
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Steel
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Nn
Hydro
Nn
Nn
Nn
Nn
Nn
Reporting &
Office
nn
nn
nn
nn
Ship
Model
nn
Statutory
nn
Steel
nn
Hydro
Nn
Report. &
Office
nn
Log / Voyage
Nn
Product Owners
(in Business Units)

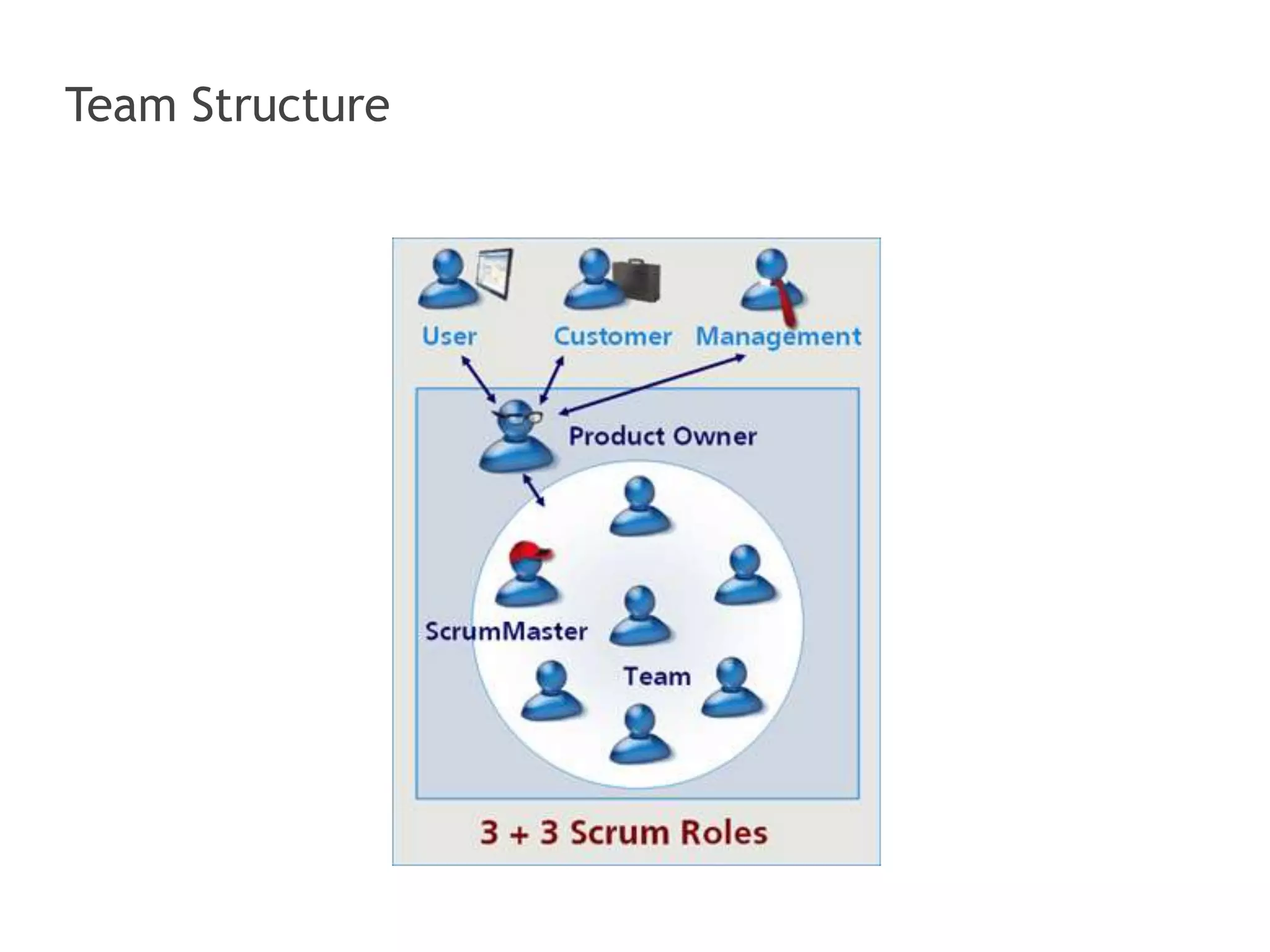

Team Structure

How we make Releases Now
Stabilization Period

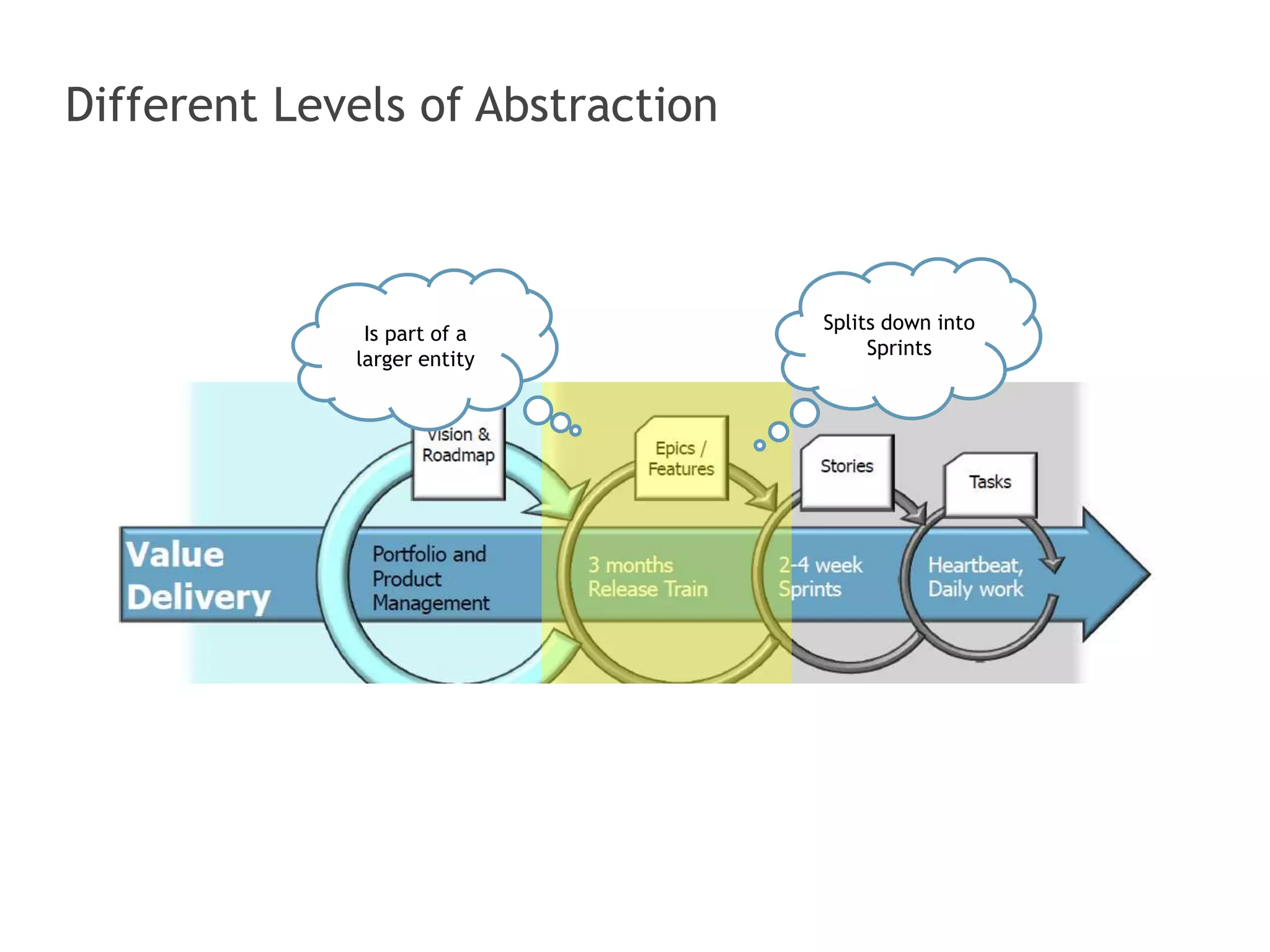

Different Levels of Abstraction
Splits down into
Sprints
Is part of a
larger entity

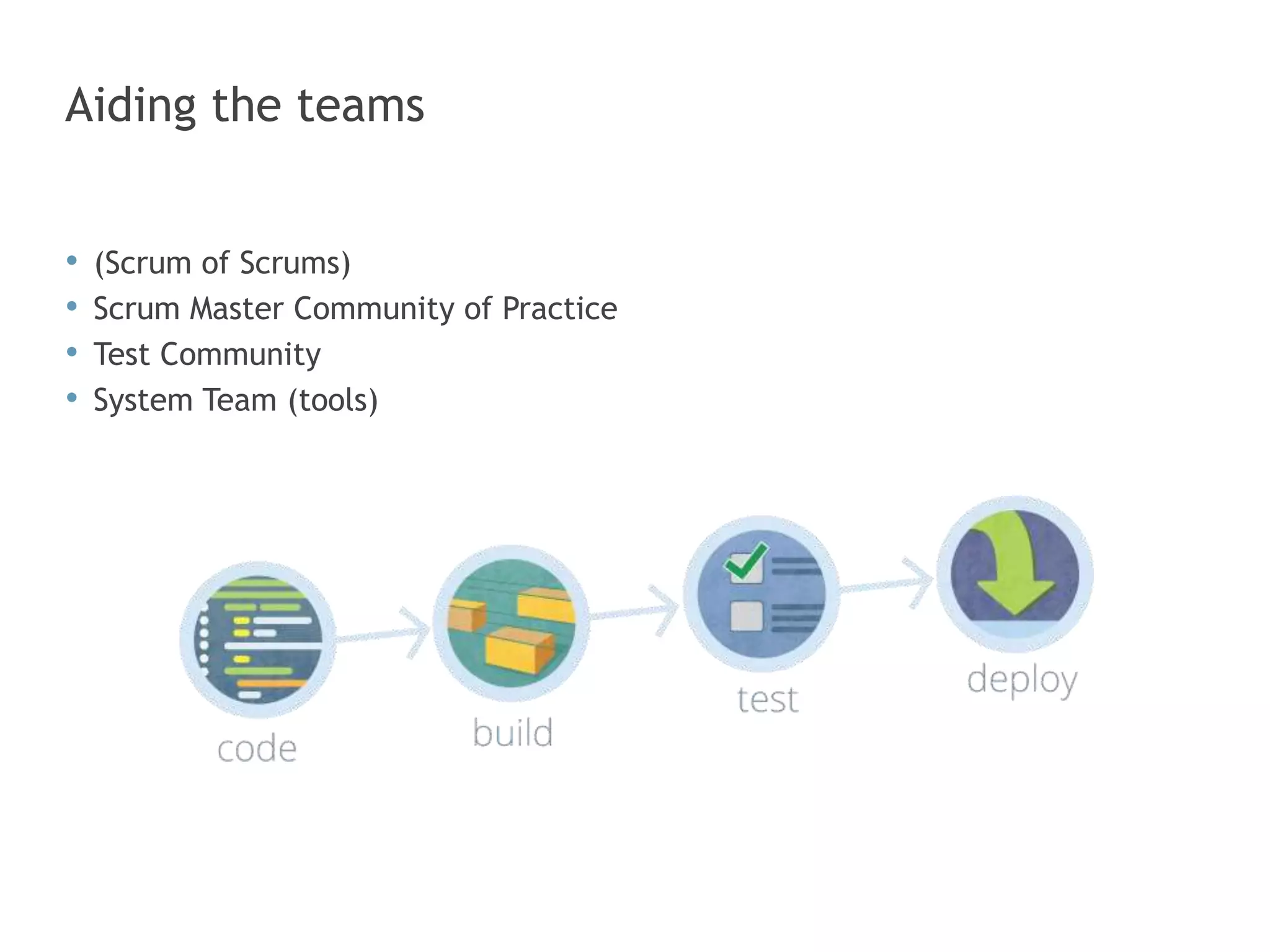

Aiding the teams
• (Scrum of Scrums)
• Scrum Master Community of Practice
• Test Community
• System Team (tools)

Split work between Product Owner and Manager
5/2013
Product Manager
Release Train Engineer
Contents
History -2012
Organizational change 2012
Release Planning Days 2014-
Increasing Transparency
w w w . n a p a . f i

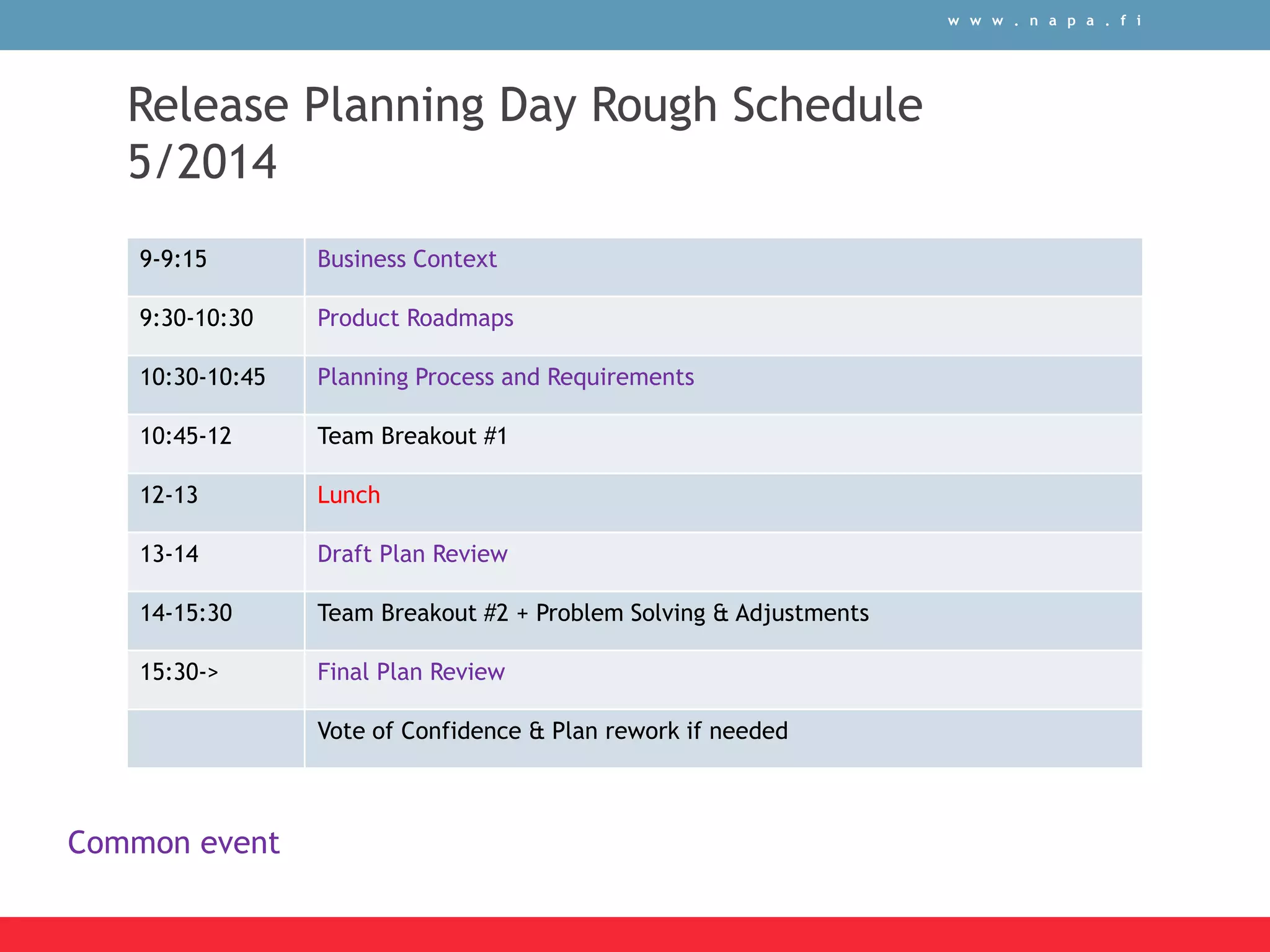

9-9:15 Business Context
9:30-10:30 Product Roadmaps
10:30-10:45 Planning Process and Requirements
10:45-12 Team Breakout #1
12-13 Lunch
13-14 Draft Plan Review
14-15:30 Team Breakout #2 + Problem Solving & Adjustments
15:30-> Final Plan Review
Vote of Confidence & Plan rework if needed
Release Planning Day Rough Schedule
5/2014
Common event
Release Planning
• Whole company together
• Event called Release Planning Day
»Why?
*see http://www.scaledagileframework.com
Shared Vision
Linking Abstraction Levels
Communication

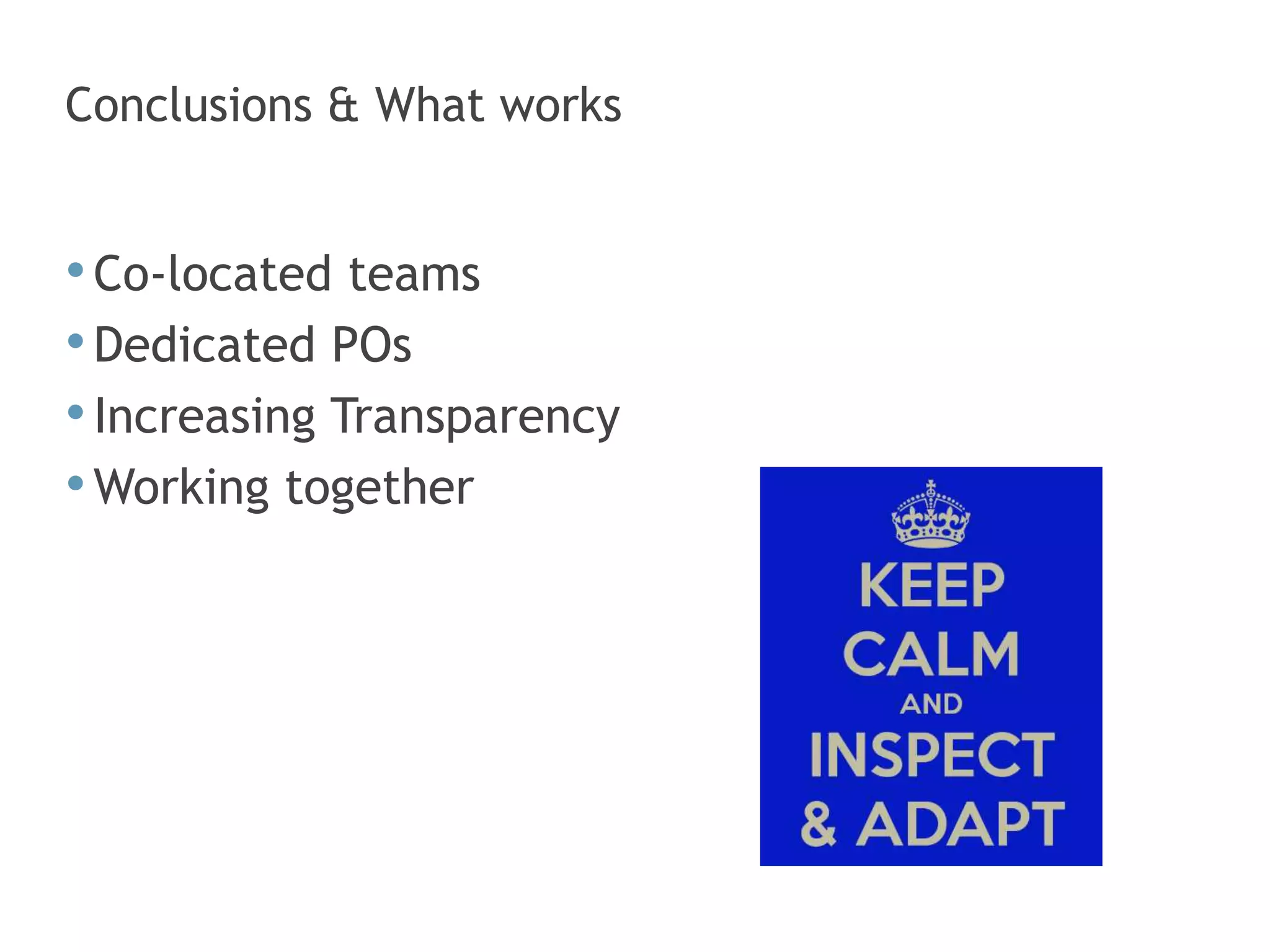

Conclusions & What works
•Co-located teams
•Dedicated POs
•Increasing Transparency
•Working together
Enjoy Working Together!
w w w . n a p a . f i
Thank You
@ToivoVaje
Toivo.vaje@napa.fi
+358-41-5372657
Manager, Software Releases
NAPA Technology

Journey from Project Organization to a SAFe Company

Editor's Notes

  • #2 Inspect and Adapt
  • #3 Just one slide about where I come from. We make software for maritime sector. We are global. We have been here for a while and we have customers. Respectful established company.
  • #4 But then again, I work there. ;)
  • #5 Three parts. First about the history.
  • #6 Found by 7 people from Wärtsilä. Unique and superior solution for the initial design part of ships including calculations.
  • #7 Company grows steadily and successfully over the years. Portfolio of products and codebases in general get bigger.
  • #8 Mode of operation still resembles small company. Release schedules slip. It’s difficult to get sw out.
  • #9 Organizational change.
  • #10 How NAPA Technology organization looked after the transformation. Tools and practices shared between teams working on same product. Many distributed teams.
  • #11 All teams using very standard, by the book Scrum. Each team has own dedicated PO, Scrum Master and Backlog.
  • #12 For us Release is a Project. We have well defined processes so by every iteration we learn to do things better.
  • #13 It’s important to understand the relation between different concepts.
  • #14 We didn’t manage to get Scrum of Scrums working properly. Other things we still do and see value in.
  • #15 Although this is generally considered antipattern, we decided to separate the roles of Product Manager and Product Owner. Both customers and teams benefit.
  • #16 Product Roadmap & Vision Long term plans (big rocks) Close to customers
  • #17 Facilitates Release events Gathers results Makes things visible
  • #18 We started Release Planning Days in 2014. The whole company attends.
  • #19 Schedule of the first ever Release Planning Day
  • #20 Why wanted to have the Release Planning Day event? I’ll tell you..
  • #21 Alignment Shared Vision Linking different abstraction levels Communication
  • #22 You probably don’t hit all the targets with one shot. Well defined processes help repeatability Empower people to make daily decisions Continuously improve your operations
  • #23 One of our core values at NAPA is that people Enjoy Working Together.
  • #24 Thank you for your interest.
