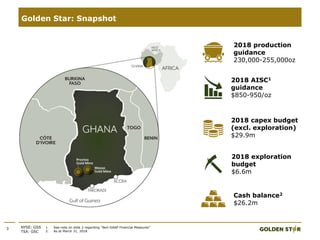

Golden Star Resources provides a summary of its Q1 2018 production results and plans for the rest of 2018. Key highlights include:

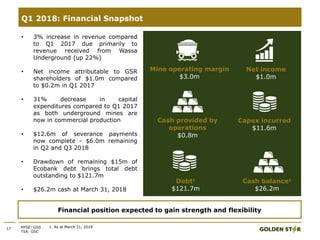

- Q1 2018 gold production of 57,616oz, with Wassa complex contributing 35,506oz and Prestea complex 22,110oz.

- Stronger than expected production from Wassa Underground of 12% higher grade than Q4 2017.

- Costs are expected to reduce through 2018 as underground production increases.

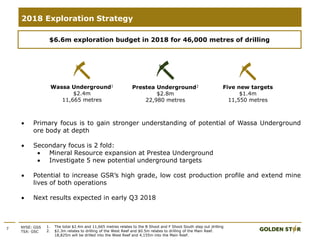

- $6.6M exploration budget aims to expand resources at Wassa Underground and Prestea Underground and test 5 new targets.
- Operational improvements expected to strengthen Prestea Underground performance in Q2 2018.
