A Rapidly Growing
                                     Metals & Mining
                                        Company

www.first-quantum.com   TSX: FM   LSE: FQM   LuSE: FQMZ
February 2012
                                       1
Cautionary Note Concerning
Forward-Looking Statements

Some of the statements contained in the following material are forward
looking statements and not statement of facts. Such statements are based on
the current beliefs of management, as well as assumptions based on
management information currently available. Forward-looking statements are
subject to various risks, uncertainties and other factors that could cause
actual results to differ materially from expected results. Readers must rely on
their own evaluation of these uncertainties.

Note: all dollar amounts in US dollars unless otherwise indicated

                                                                              2
First Quantum
What Do Our Shareholders Own?
• A substantial copper producer with a
  pipeline of expansions and new projects

• An emerging nickel producer with growth
  opportunities

• A strong balance sheet

• Production in an industry with strong
  fundamentals

• Most importantly, the ability to add value
  through efficient delivery of growth at
  costs below industry norms                   3

What We Have Delivered So Far
Copper Growth (1)                                                                  Total Annualised Shareholder Return (2)
2000-2011 CAGR (%)                                                                 January 2000 – December 2011 (%)
             Barrick                                                         34%    First Quantum                                           32%
                                                                                            Inmet                                     24%
    Southern Copper                                                    23%
                                                                                    Southern Peru                                22%
       First Quantum                                                 22%
                                                                                      Antofagasta                               21%
             Xstrata                                             20%                      Norilsk                         15%
               Teck                                            18%                           Vale                   12%
                                                                                      BHP Billiton             7%
            Freeport                                   12%
                                                                                             Teck              6%
            Glencore                                  10%
                                                                                          Eramet               6%
         Antofagasta                             7%                                      Freeport         4%
     Anglo American                         4%                                            Hudbay          3%

              BHPB                          3%
                                                                                           Lundin         3%
                                                                                         Rio Tinto        2%
             Norilsk                   1%
                                                                                          Xstrata     2%
            Codelco                   1%
                                                                                         Vedanta      2%
              KGHM                    0%                                           Anglo American     2%

         Kazakhmys           (1)%                                                      Kazakhmys     1%
                                                                                            ENRC     0%
           Rio Tinto    (4)%

(1) Source: Brook Hunt. Inclusive of corporate acquisitions.
(2) Source: CapIQ.                                                                                                                          4

Long-Term Targets
1000             Copper Production           125         Nickel Production
                   000’s tonnes                            000’s tonnes
800                                          100

600                                           75

400                                           50

200                                           25

   0                                           0
       04   06   08     10 12F 14F 16F 18F         04    06    08   10 12F 14F 16F 18F
                 Base    Projects                       Base    Projects   Optional

                                                                                         5

What We Are Looking to Deliver:
 Copper Growth Remains Best in Class
2016 Copper Producer Landscape                                                        Copper Growth
(Mt)            6th Largest Global                          13th Largest Global       2011 – 2016 CAGR (%)
                Copper Producer                              Copper Producer                 FQM             29.2%
                      by 2016                                    Currently                   Vale

                                                                                         S Copper

                                                                                           Xstrata

                                                                                         Glencore

                                                                                         Rio Tinto

                                                                                        Kazakhmys
                        1.0
                                                                                           Barrick

                                                                                          Vedanta

                                                                                           KGHM

                                                                                            BHPB

                                                                                           Norilsk

                                                                                          Codelco
                                                                                0.3
                                                                                            Anglo

                                                                                          Freeport

                                                                                       Antofagasta

                                                                                             Teck

                                                                                                             6
 Source: Brook Hunt. First Quantum estimates based on management projections.
Tripling Copper
  Production
    Capacity

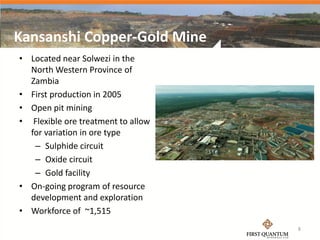

Kansanshi Copper-Gold Mine
• Located near Solwezi in the
  North Western Province of
  Zambia
• First production in 2005
• Open pit mining
• Flexible ore treatment to allow
  for variation in ore type
   – Sulphide circuit
   – Oxide circuit
   – Gold facility
• On-going program of resource
  development and exploration
• Workforce of ~1,515
                                    8
Kansanshi
Mining Volumes & Strip Ratio

                               9

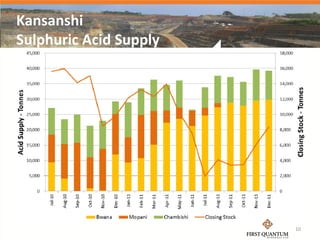

Kansanshi
Sulphuric Acid Supply

                        10
Kansanshi
Improving Ore Availability

                             11
Kansanshi

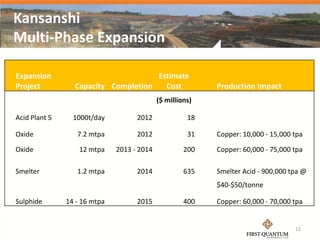

Multi-Phase Expansion

Expansion                            Estimate
Project          Capacity Completion   Cost                Production Impact
                                            ($ millions)

Acid Plant 5     1000t/day          2012              18

Oxide             7.2 mtpa          2012              31   Copper: 10,000 - 15,000 tpa

Oxide              12 mtpa    2013 - 2014            200   Copper: 60,000 - 75,000 tpa

Smelter           1.2 mtpa          2014             635   Smelter Acid - 900,000 tpa @
                                                           $40-$50/tonne

Sulphide       14 - 16 mtpa         2015             400   Copper: 60,000 - 70,000 tpa

                                                                                   12
Kansanshi
Copper Smelter Project Parameters
• Concentrate feed rate 1.2 Mtpa
    —67% Sentinel
    —33% Kansanshi
    —Average copper grade 26%

• Blister copper production
  300,000 tpa

• Acid production 1.0 Mtpa

                                    13

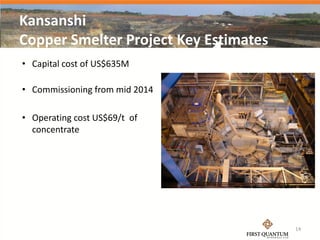

Kansanshi
Copper Smelter Project Key Estimates
• Capital cost of US$635M

• Commissioning from mid 2014

• Operating cost US$69/t of
  concentrate

                                       14

Economic Benefits of the Copper Smelter
  Transport
  Kansanshi           100% to Zambian Smelters
  Sentinel            900,00 – 1,200,000 to export less 300,000 t Blister
  Cost per annum      @ $220/t:            $130M to $ 200M

  Export Levy
  Current             10% of export value
  Sentinel            Annual export
                      230,000 – 310,000 copper in concentrate
  Cost per annum      Cu @ $ 7,000/t:     $160M to $ 220M

  Acid Supply
  Current consumption 1,200 tpd @$ 200/t:   $ 90Mpa
  Increase with AP5   + 900 tpd @$ 200/t:   $ 150Mpa

  Annual Savings                            $ 340M to    $ 510M

                                                                            15

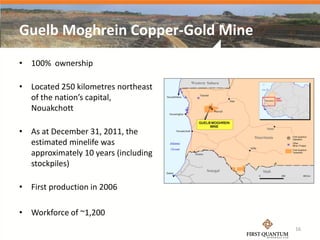

Guelb Moghrein Copper-Gold Mine
• 100% ownership

• Located 250 kilometres northeast
  of the nation’s capital,
  Nouakchott

• As at December 31, 2011, the
  estimated minelife was
  approximately 10 years (including
  stockpiles)

• First production in 2006

• Workforce of ~1,200
                                      16

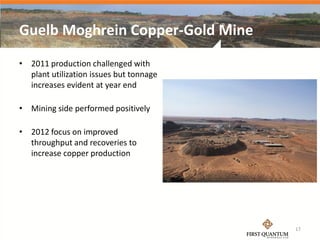

Guelb Moghrein Copper-Gold Mine
• 2011 production challenged with
  plant utilization issues but tonnage
  increases evident at year end

• Mining side performed positively

• 2012 focus on improved
  throughput and recoveries to
  increase copper production

                                         17

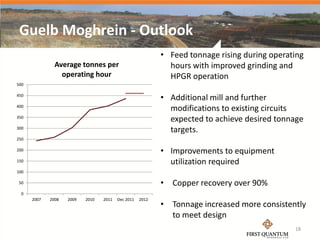

Guelb Moghrein - Outlook
                                                           • Feed tonnage rising during operating
               Average tonnes per                            hours with improved grinding and
                 operating hour                              HPGR operation
500

450
                                                           • Additional mill and further
400
                                                             modifications to existing circuits
350
                                                             expected to achieve desired tonnage
300
                                                             targets.
250

200                                                        • Improvements to equipment
150                                                          utilization required
100

50                                                         • Copper recovery over 90%
  0
      2007   2008   2009   2010   2011   Dec 2011   2012
                                                           • Tonnage increased more consistently
                                                             to meet design
                                                                                              18

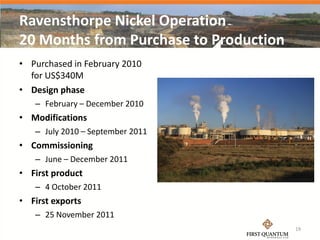

Ravensthorpe Nickel Operation
20 Months from Purchase to Production
• Purchased in February 2010
  for US$340M
• Design phase
   – February – December 2010
• Modifications
   – July 2010 – September 2011
• Commissioning
   – June – December 2011
• First product
   – 4 October 2011
• First exports
   – 25 November 2011
                                        19

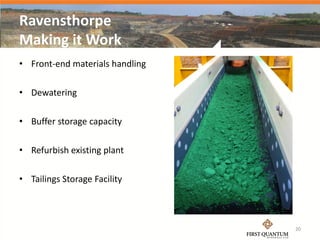

Ravensthorpe
Making it Work
• Front-end materials handling

• Dewatering

• Buffer storage capacity

• Refurbish existing plant

• Tailings Storage Facility

                                 20
Ravensthorpe

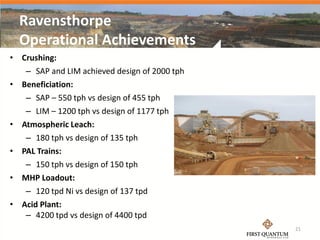

  Operational Achievements
• Crushing:
   – SAP and LIM achieved design of 2000 tph
• Beneficiation:
   – SAP – 550 tph vs design of 455 tph
   – LIM – 1200 tph vs design of 1177 tph
• Atmospheric Leach:
   – 180 tph vs design of 135 tph
• PAL Trains:
   – 150 tph vs design of 150 tph
• MHP Loadout:
   – 120 tpd Ni vs design of 137 tpd
• Acid Plant:
   – 4200 tpd vs design of 4400 tpd
                                               21

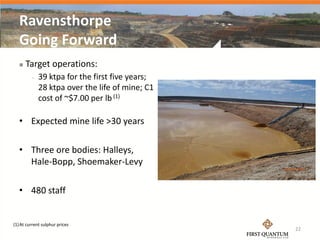

Ravensthorpe
   Going Forward
      Target operations:
            39 ktpa for the first five years;
             28 ktpa over the life of mine; C1
             cost of ~$7.00 per lb (1)

   • Expected mine life >30 years

   • Three ore bodies: Halleys,
     Hale-Bopp, Shoemaker-Levy

   • 480 staff

(1) At current sulphur prices
                                                 22
Kevitsa Nickel-Copper-PGE Project
• 100% owned; Acquired in 2008

• Large undeveloped sulphide nickel
  deposit suitable for open cast mining

• 240M tonnes @ 0.30% Ni (0.28
  NiSulphide) and 0.41% Cu

• Initial ore feed of 5.5 mt/yr with
  intention to expand by ~50% in 2013

• On-going drill program continues to
  deliver encouraging results

                                          23

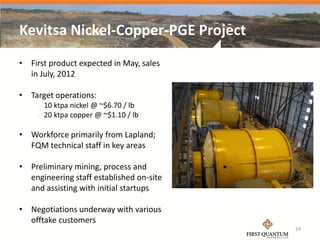

Kevitsa Nickel-Copper-PGE Project
• First product expected in May, sales
  in July, 2012

• Target operations:
        10 ktpa nickel @ ~$6.70 / lb
        20 ktpa copper @ ~$1.10 / lb

• Workforce primarily from Lapland;
  FQM technical staff in key areas

• Preliminary mining, process and
  engineering staff established on-site
  and assisting with initial startups

• Negotiations underway with various
  offtake customers
                                          24

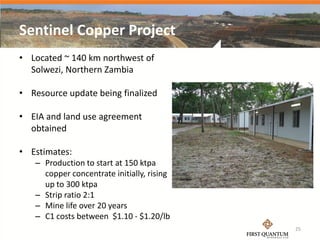

Sentinel Copper Project
• Located ~ 140 km northwest of
  Solwezi, Northern Zambia

• Resource update being finalized

• EIA and land use agreement
  obtained

• Estimates:
   – Production to start at 150 ktpa
     copper concentrate initially, rising
     up to 300 ktpa
   – Strip ratio 2:1
   – Mine life over 20 years
   – C1 costs between $1.10 - $1.20/lb
                                            25

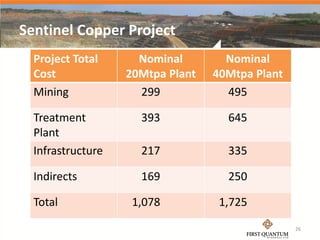

Sentinel Copper Project
  Project Total      Nominal        Nominal
  Cost             20Mtpa Plant   40Mtpa Plant
  Mining             299            495

  Treatment          393            645
  Plant
  Infrastructure     217            335

  Indirects          169            250

  Total             1,078          1,725
                                                 26
Sentinel Copper Project
Project Status
• Committed deliveries for mills,
  gearless mill drives, crushers
  and mining fleet

• Flowsheets completed

• Concept layouts and detailed
  estimates complete

• Equipment list complete

• 300-man construction camp
  complete

                                    27
Sentinel Copper Project
Project Status
• Power scope defined and
  commercial discussions are
  continuing

• Mine planning commenced

• Internal reviews undertaken
• Site access complete

• Pending Board approval

                                28

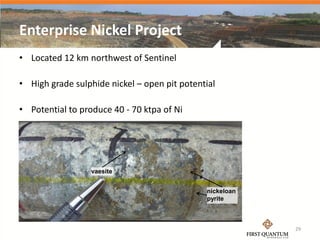

Enterprise Nickel Project
• Located 12 km northwest of Sentinel

• High grade sulphide nickel – open pit potential

• Potential to produce 40 - 70 ktpa of Ni

                  vaesite

                                              nickeloan
                                              pyrite

                                                          29
Enterprise Nickel Project
• Current focus – continue to
  define resource, design the
  mine and confirm process route

• Campaign treatment at the
  Sentinel facilities significantly
  reduces capital – utilization of
  re-grind mills and cleaner
  circuits

• Open pit mining – potential
  one-off pre-strip utilizing
  Sentinel mining fleet
                                      30
Haquira Copper Project
• Acquired in December 2010
• Large scale copper project
  located in southern Peru
      M&I resource of 3.7 Mt of
       copper equivalent and an
       inferred resource of 2.4 Mt of
       copper equivalent
• Currently focused on:
      Community relations and land
       access
      Expanding infill and
       condemnation drill program
       and environmental matters

                                        31
Long-term
      Copper
     Dynamics

15

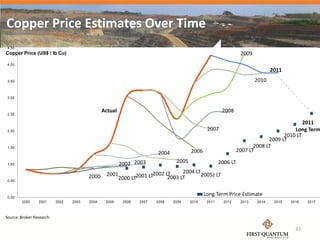

Copper Price Estimates Over Time
 4.50
Copper Price (US$ / lb Cu)                                                                                       2009
 4.00
                                                                                                                               2011
 3.50                                                                                                                   2010

 3.00

                                               Actual                                                  2008
 2.50

                                                                                                                                           2011
 2.00                                                                                          2007                                    Long Term
                                                                                                                                   2010 LT
                                                                                                                             2009 LT
 1.50                                                                                                                  2008 LT
                                                                        2004           2006                     2007 LT

 1.00                                                   2002 2003               2005                  2006 LT
                                                                                  2004 LT
                                        2000    2001
                                                        2000 LT2001 LT2002 LT
                                                                            2003 LT       2005z LT
 0.50

 0.00
                                                                                              Long Term Price Estimate
        2000     2001     2002   2003   2004    2005     2006   2007   2008    2009    2010    2011     2012     2013   2014    2015   2016   2017

Source: Broker Research

                                                                                                                                         33
Surpluses Overestimated & Deficits Underestimated
 Brook Hunt Supply / Demand – Forecast vs. Actual
 Supply / Demand Surplus (Deficit) (ktpa)
                                                                                                                                               Copper Demand (ktpa)
 1,500                                                                                                                                                         19,000

                                                                                         1,137
                                                                                                                                   960
 1,000
                                                                                                                                         737
                                                                                                                             648                               18,000

   500                                                                                                       424
                                                                                                                       295
                                                                          236

                                    0                                                             78
     0                                                                                                                                                         17,000
             (77)
                                                                                 (134)                                                            (135)
                     (293)                                    (334)
 (500)                                                (422)

                                                                                                                                                               16,000

(1,000)

                                            (1,080)

(1,500)                                                                                                                                                        15,000
                 2003                   2004             2005                 2006            2007              2008           2009            2010

                                                                3-Year Prior Estimate    Actual        Copper Demand

Source: Brook Hunt and USGS
                                                                                                                                                          34

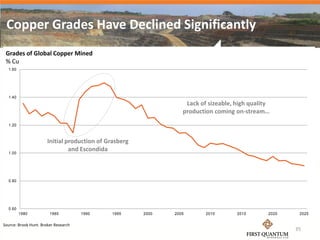

Copper Grades Have Declined Significantly
 Grades of Global Copper Mined
 % Cu
  1.60

  1.40
                                                                   Lack of sizeable, high quality
                                                                  production coming on-stream…
  1.20

                       Initial production of Grasberg
  1.00
                                and Escondida

  0.80

  0.60
         1980           1985          1990     1995     2000   2005       2010       2015       2020    2025

Source: Brook Hunt. Broker Research
                                                                                                       35

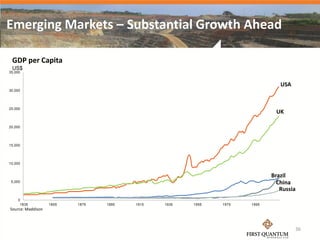

Emerging Markets – Substantial Growth Ahead

 GDP per Capita
 US$
35,000

                                                                              USA
30,000

25,000
                                                                            UK

20,000

15,000

10,000

                                                                           Brazil
 5,000                                                                       China
                                                                              Russia
     0
      1835         1855   1875   1895   1915   1935   1955   1975   1995
Source: Maddison

                                                                                    36
Projected Impact on the Copper Market
Key Points                                           Intensity of Refined Copper Consumption (1)                               Multiple of India, Brazil, China
                                                     kg Cu per capita                                                                                                                  7.1x
   Should China, India and Brazil all                25                                                                       Average Intensity of Use (x)
    grow in line with population                                  Aggregate Copper Use                                                                                       6.1x           21.50
    forecasts and reach copper use                    20          per Capita:                                                                                                 18.50
    per capita equivalent to, say, the                            3.0 kg per capita                                                                               4.5x
    EU-27 country group by 2020, the                  15                                                                                                            13.7
    increased annual copper demand                                                                                                                   2.3x
    would be approximately 10                                                                                                      2.1x
                                                      10
    Mtpa, equivalent to:                                                                                                              6.30             7.00
                                                                                                    5.50
        –   ca. 60% of current annual                   5
                                                                                   1.80
            global copper demand                                  0.55
                                                        0
        –   Nine new Escondidas being                             India           Brazil           China                             EU 27             Japan       Germany    Korea         Taiwan
            brought on line
                                                    Source: International Copper Study Group

Illustrative Scenarios                                                                                            New Annual                                No. of New                No. of New
Assuming Increased Intensity of Cu Consumption for China, India and Brazil                                        Cu demand                                 Escondidas (2)            First
                                                                                                                                                                                      Quantum’s
                                                                                                                                                                                      (3)

           If China, India and Brazil reach the copper
            intensity of EU27 countries by 2020, this equates
            to...
           If China, India and Brazil reach the copper
            intensity of Japan by 2020, this equates to...

           If China, India and Brazil reach the copper
            intensity of Germany by 2020, this equates to...
(1) Defined as copper consumed by semis fabricators or “first users” of refined copper (ingot makers, master alloy plants, wire rod plants, brass mills, alloy
    wire mills, foundries and foil mills)
(2) Based on Escondida 2010 production of 1.09 Mt
                                                                                                                                                                                             37
(3) Based on FM 2010 production of 323 kt
Projects Less Sensitive to Copper Prices

Top 25 Copper Projects                                                       Capex Intensity (US$ / t)

  Minimum Required Copper Price to Generate 15% IRR (US$ / tonne Cu)                   Cobre Panama (Inmet)                    $ 21,622
                                                                                      Caracoles (Antofagasta)                 $ 20,421
                                                                                       Caserones (JX Nippon)                  $ 20,045
                                                                                   Sierra Gorda (Quadra FNX)                  $ 19,895
                                                                                          El Moro (GoldCorp)                 $ 18,551
                                                                                    Telegrapho (Antofagasta)                 $ 18,472
                                                                                          Tampakan (Xstrata)                 $ 18,400
                                                                                       Toromocho (Chinalco)                 $ 17,325
                                                                                         Oyu Tolgoi (Ivanhoe)              $ 16,602
                                                                                         Las Bambas (Xstrata)              $ 15,759
                                                                                                Salobo (Vale)              $ 15,514
                                                                                   Los Bronces (Anglo Amer.)               $ 15,474
                                                                                       Cerro Verde (Freeport)              $ 15,470
                                                                                Ministro Mina Hales (Codelco)              $ 15,435
                                                                                      Quebrada Blanca (Teck)           $ 15,000
                                                                                        Canariaco (Candente)           $ 14,672
                                                                                    Quellaveco (Anglo Amer.)           $ 14,667
                                                                                              Haquira (FQM)            $ 14,290
                                                                                            Rio Blanco (Zijin)        $ 13,611
                                                                                             Antamina (BHP)          $ 11,550
                                                                                         Antapaccay (Xstrata)       $ 10,794
                                                                                         Galeno (Minmetals)         $ 10,696
                                                                                              Sentinel (FQM)       $ 9,079
                                                                                  Buenavista DC (South. Cop)      $ 8,061
                                                                                      Konkola Deep (Vedanta)     $ 6,130
                                                 Cumulative Production (paid kt Cu)
Source: Brook Hunt, equity research estimates.                                                                                    38
Agreement to Dispose of DRC Assets

• Agreement with ENRC to dispose of all residual claims and assets

• Total consideration of $1.25B – consisting of:
    – $750M payable on closing
    – $500M three-year promissory note with a 3% interest coupon

• Condition of closing
    – FQM, ENRC and DRC government will settle all disputes relating to the companies
      beings sold, their assets and operations in the DRC, and
    – FQM. ENRC and DRC government will be releasing one another in respect of all
      claims and judgments related to the foregoing or to any other matter arising in the
      DRC on or before the date of closing

• Transaction closing expected on or before February 29, 2012

                                                                                        39
A Rapidly Growing Mining & Metals Company

• Unique core technical strength behind the strong track record of value
  creation

• Existing operations provide a solid platform to support growth

• Strong financial position and cash flow

• ~$5 billion investment in growth over 2012 – 2016 to significantly increase
  copper and nickel production

• Growth program expected to position First Quantum as the world’s 6th
  largest copper producer and a top ten nickel producer

                                                                            40
A Rapidly Growing
                                    Metals & Mining
                                             Company

www.first-quantum.com   TSX: FM   LSE: FQM   LuSE: FQMZ
February 2012
                                       1
Corporate Profile

   Stock exchange listings & symbols – (S&P/TSX 60 Index)   TSX: FM LSE: FQM LuSE: FQMZ

   Shares issued and outstanding                                            476.3 million

   Fully diluted                                                            476.3 million

   52-week share price range                                           C$29.60 – C$12.60

   Recent share price – February 17, 2012                                       C$22.24

   Market capitalization – $ millions                                      C$11.4 billion

   Average daily trading volume - shares                                     1.6 million

   Dividend paid in regards to year 2010 – per share                              C$0.80
                                                                        US=36%; UK=26%;
   Geographic breakdown of institutional shareholders
                                                                   Canada=23%; other=15%

                                                                                            42

Investor presentation february

  • 1.
    A Rapidly Growing Metals & Mining Company www.first-quantum.com TSX: FM LSE: FQM LuSE: FQMZ February 2012 1
  • 2.
    Cautionary Note Concerning Forward-LookingStatements Some of the statements contained in the following material are forward looking statements and not statement of facts. Such statements are based on the current beliefs of management, as well as assumptions based on management information currently available. Forward-looking statements are subject to various risks, uncertainties and other factors that could cause actual results to differ materially from expected results. Readers must rely on their own evaluation of these uncertainties. Note: all dollar amounts in US dollars unless otherwise indicated 2
  • 3.
    First Quantum What DoOur Shareholders Own? • A substantial copper producer with a pipeline of expansions and new projects • An emerging nickel producer with growth opportunities • A strong balance sheet • Production in an industry with strong fundamentals • Most importantly, the ability to add value through efficient delivery of growth at costs below industry norms 3
  • 4.
    What We HaveDelivered So Far Copper Growth (1) Total Annualised Shareholder Return (2) 2000-2011 CAGR (%) January 2000 – December 2011 (%) Barrick 34% First Quantum 32% Inmet 24% Southern Copper 23% Southern Peru 22% First Quantum 22% Antofagasta 21% Xstrata 20% Norilsk 15% Teck 18% Vale 12% BHP Billiton 7% Freeport 12% Teck 6% Glencore 10% Eramet 6% Antofagasta 7% Freeport 4% Anglo American 4% Hudbay 3% BHPB 3% Lundin 3% Rio Tinto 2% Norilsk 1% Xstrata 2% Codelco 1% Vedanta 2% KGHM 0% Anglo American 2% Kazakhmys (1)% Kazakhmys 1% ENRC 0% Rio Tinto (4)% (1) Source: Brook Hunt. Inclusive of corporate acquisitions. (2) Source: CapIQ. 4
  • 5.
    Long-Term Targets 1000 Copper Production 125 Nickel Production 000’s tonnes 000’s tonnes 800 100 600 75 400 50 200 25 0 0 04 06 08 10 12F 14F 16F 18F 04 06 08 10 12F 14F 16F 18F Base Projects Base Projects Optional 5
  • 6.
    What We AreLooking to Deliver: Copper Growth Remains Best in Class 2016 Copper Producer Landscape Copper Growth (Mt) 6th Largest Global 13th Largest Global 2011 – 2016 CAGR (%) Copper Producer Copper Producer FQM 29.2% by 2016 Currently Vale S Copper Xstrata Glencore Rio Tinto Kazakhmys 1.0 Barrick Vedanta KGHM BHPB Norilsk Codelco 0.3 Anglo Freeport Antofagasta Teck 6 Source: Brook Hunt. First Quantum estimates based on management projections.
  • 7.
    Tripling Copper Production Capacity
  • 8.
    Kansanshi Copper-Gold Mine •Located near Solwezi in the North Western Province of Zambia • First production in 2005 • Open pit mining • Flexible ore treatment to allow for variation in ore type – Sulphide circuit – Oxide circuit – Gold facility • On-going program of resource development and exploration • Workforce of ~1,515 8
  • 9.
  • 10.
  • 11.
  • 12.
    Kansanshi Multi-Phase Expansion Expansion Estimate Project Capacity Completion Cost Production Impact ($ millions) Acid Plant 5 1000t/day 2012 18 Oxide 7.2 mtpa 2012 31 Copper: 10,000 - 15,000 tpa Oxide 12 mtpa 2013 - 2014 200 Copper: 60,000 - 75,000 tpa Smelter 1.2 mtpa 2014 635 Smelter Acid - 900,000 tpa @ $40-$50/tonne Sulphide 14 - 16 mtpa 2015 400 Copper: 60,000 - 70,000 tpa 12
  • 13.
    Kansanshi Copper Smelter ProjectParameters • Concentrate feed rate 1.2 Mtpa —67% Sentinel —33% Kansanshi —Average copper grade 26% • Blister copper production 300,000 tpa • Acid production 1.0 Mtpa 13
  • 14.
    Kansanshi Copper Smelter ProjectKey Estimates • Capital cost of US$635M • Commissioning from mid 2014 • Operating cost US$69/t of concentrate 14
  • 15.
    Economic Benefits ofthe Copper Smelter Transport Kansanshi 100% to Zambian Smelters Sentinel 900,00 – 1,200,000 to export less 300,000 t Blister Cost per annum @ $220/t: $130M to $ 200M Export Levy Current 10% of export value Sentinel Annual export 230,000 – 310,000 copper in concentrate Cost per annum Cu @ $ 7,000/t: $160M to $ 220M Acid Supply Current consumption 1,200 tpd @$ 200/t: $ 90Mpa Increase with AP5 + 900 tpd @$ 200/t: $ 150Mpa Annual Savings $ 340M to $ 510M 15
  • 16.
    Guelb Moghrein Copper-GoldMine • 100% ownership • Located 250 kilometres northeast of the nation’s capital, Nouakchott • As at December 31, 2011, the estimated minelife was approximately 10 years (including stockpiles) • First production in 2006 • Workforce of ~1,200 16
  • 17.
    Guelb Moghrein Copper-GoldMine • 2011 production challenged with plant utilization issues but tonnage increases evident at year end • Mining side performed positively • 2012 focus on improved throughput and recoveries to increase copper production 17
  • 18.
    Guelb Moghrein -Outlook • Feed tonnage rising during operating Average tonnes per hours with improved grinding and operating hour HPGR operation 500 450 • Additional mill and further 400 modifications to existing circuits 350 expected to achieve desired tonnage 300 targets. 250 200 • Improvements to equipment 150 utilization required 100 50 • Copper recovery over 90% 0 2007 2008 2009 2010 2011 Dec 2011 2012 • Tonnage increased more consistently to meet design 18
  • 19.
    Ravensthorpe Nickel Operation 20Months from Purchase to Production • Purchased in February 2010 for US$340M • Design phase – February – December 2010 • Modifications – July 2010 – September 2011 • Commissioning – June – December 2011 • First product – 4 October 2011 • First exports – 25 November 2011 19
  • 20.
    Ravensthorpe Making it Work •Front-end materials handling • Dewatering • Buffer storage capacity • Refurbish existing plant • Tailings Storage Facility 20
  • 21.
    Ravensthorpe OperationalAchievements • Crushing: – SAP and LIM achieved design of 2000 tph • Beneficiation: – SAP – 550 tph vs design of 455 tph – LIM – 1200 tph vs design of 1177 tph • Atmospheric Leach: – 180 tph vs design of 135 tph • PAL Trains: – 150 tph vs design of 150 tph • MHP Loadout: – 120 tpd Ni vs design of 137 tpd • Acid Plant: – 4200 tpd vs design of 4400 tpd 21
  • 22.
    Ravensthorpe Going Forward  Target operations:  39 ktpa for the first five years; 28 ktpa over the life of mine; C1 cost of ~$7.00 per lb (1) • Expected mine life >30 years • Three ore bodies: Halleys, Hale-Bopp, Shoemaker-Levy • 480 staff (1) At current sulphur prices 22
  • 23.
    Kevitsa Nickel-Copper-PGE Project •100% owned; Acquired in 2008 • Large undeveloped sulphide nickel deposit suitable for open cast mining • 240M tonnes @ 0.30% Ni (0.28 NiSulphide) and 0.41% Cu • Initial ore feed of 5.5 mt/yr with intention to expand by ~50% in 2013 • On-going drill program continues to deliver encouraging results 23
  • 24.
    Kevitsa Nickel-Copper-PGE Project •First product expected in May, sales in July, 2012 • Target operations:  10 ktpa nickel @ ~$6.70 / lb  20 ktpa copper @ ~$1.10 / lb • Workforce primarily from Lapland; FQM technical staff in key areas • Preliminary mining, process and engineering staff established on-site and assisting with initial startups • Negotiations underway with various offtake customers 24
  • 25.
    Sentinel Copper Project •Located ~ 140 km northwest of Solwezi, Northern Zambia • Resource update being finalized • EIA and land use agreement obtained • Estimates: – Production to start at 150 ktpa copper concentrate initially, rising up to 300 ktpa – Strip ratio 2:1 – Mine life over 20 years – C1 costs between $1.10 - $1.20/lb 25
  • 26.
    Sentinel Copper Project Project Total Nominal Nominal Cost 20Mtpa Plant 40Mtpa Plant Mining 299 495 Treatment 393 645 Plant Infrastructure 217 335 Indirects 169 250 Total 1,078 1,725 26
  • 27.
    Sentinel Copper Project ProjectStatus • Committed deliveries for mills, gearless mill drives, crushers and mining fleet • Flowsheets completed • Concept layouts and detailed estimates complete • Equipment list complete • 300-man construction camp complete 27
  • 28.
    Sentinel Copper Project ProjectStatus • Power scope defined and commercial discussions are continuing • Mine planning commenced • Internal reviews undertaken • Site access complete • Pending Board approval 28
  • 29.
    Enterprise Nickel Project •Located 12 km northwest of Sentinel • High grade sulphide nickel – open pit potential • Potential to produce 40 - 70 ktpa of Ni vaesite nickeloan pyrite 29
  • 30.
    Enterprise Nickel Project •Current focus – continue to define resource, design the mine and confirm process route • Campaign treatment at the Sentinel facilities significantly reduces capital – utilization of re-grind mills and cleaner circuits • Open pit mining – potential one-off pre-strip utilizing Sentinel mining fleet 30
  • 31.
    Haquira Copper Project •Acquired in December 2010 • Large scale copper project located in southern Peru  M&I resource of 3.7 Mt of copper equivalent and an inferred resource of 2.4 Mt of copper equivalent • Currently focused on:  Community relations and land access  Expanding infill and condemnation drill program and environmental matters 31
  • 32.
    Long-term Copper Dynamics 15
  • 33.
    Copper Price EstimatesOver Time 4.50 Copper Price (US$ / lb Cu) 2009 4.00 2011 3.50 2010 3.00 Actual 2008 2.50 2011 2.00 2007 Long Term 2010 LT 2009 LT 1.50 2008 LT 2004 2006 2007 LT 1.00 2002 2003 2005 2006 LT 2004 LT 2000 2001 2000 LT2001 LT2002 LT 2003 LT 2005z LT 0.50 0.00 Long Term Price Estimate 2000 2001 2002 2003 2004 2005 2006 2007 2008 2009 2010 2011 2012 2013 2014 2015 2016 2017 Source: Broker Research 33
  • 34.
    Surpluses Overestimated &Deficits Underestimated Brook Hunt Supply / Demand – Forecast vs. Actual Supply / Demand Surplus (Deficit) (ktpa) Copper Demand (ktpa) 1,500 19,000 1,137 960 1,000 737 648 18,000 500 424 295 236 0 78 0 17,000 (77) (134) (135) (293) (334) (500) (422) 16,000 (1,000) (1,080) (1,500) 15,000 2003 2004 2005 2006 2007 2008 2009 2010 3-Year Prior Estimate Actual Copper Demand Source: Brook Hunt and USGS 34
  • 35.
    Copper Grades HaveDeclined Significantly Grades of Global Copper Mined % Cu 1.60 1.40 Lack of sizeable, high quality production coming on-stream… 1.20 Initial production of Grasberg 1.00 and Escondida 0.80 0.60 1980 1985 1990 1995 2000 2005 2010 2015 2020 2025 Source: Brook Hunt. Broker Research 35
  • 36.
    Emerging Markets –Substantial Growth Ahead GDP per Capita US$ 35,000 USA 30,000 25,000 UK 20,000 15,000 10,000 Brazil 5,000 China Russia 0 1835 1855 1875 1895 1915 1935 1955 1975 1995 Source: Maddison 36
  • 37.
    Projected Impact onthe Copper Market Key Points Intensity of Refined Copper Consumption (1) Multiple of India, Brazil, China kg Cu per capita 7.1x  Should China, India and Brazil all 25 Average Intensity of Use (x) grow in line with population Aggregate Copper Use 6.1x 21.50 forecasts and reach copper use 20 per Capita: 18.50 per capita equivalent to, say, the 3.0 kg per capita 4.5x EU-27 country group by 2020, the 15 13.7 increased annual copper demand 2.3x would be approximately 10 2.1x 10 Mtpa, equivalent to: 6.30 7.00 5.50 – ca. 60% of current annual 5 1.80 global copper demand 0.55 0 – Nine new Escondidas being India Brazil China EU 27 Japan Germany Korea Taiwan brought on line Source: International Copper Study Group Illustrative Scenarios New Annual No. of New No. of New Assuming Increased Intensity of Cu Consumption for China, India and Brazil Cu demand Escondidas (2) First Quantum’s (3)  If China, India and Brazil reach the copper intensity of EU27 countries by 2020, this equates to...  If China, India and Brazil reach the copper intensity of Japan by 2020, this equates to...  If China, India and Brazil reach the copper intensity of Germany by 2020, this equates to... (1) Defined as copper consumed by semis fabricators or “first users” of refined copper (ingot makers, master alloy plants, wire rod plants, brass mills, alloy wire mills, foundries and foil mills) (2) Based on Escondida 2010 production of 1.09 Mt 37 (3) Based on FM 2010 production of 323 kt
  • 38.
    Projects Less Sensitiveto Copper Prices Top 25 Copper Projects Capex Intensity (US$ / t) Minimum Required Copper Price to Generate 15% IRR (US$ / tonne Cu) Cobre Panama (Inmet) $ 21,622 Caracoles (Antofagasta) $ 20,421 Caserones (JX Nippon) $ 20,045 Sierra Gorda (Quadra FNX) $ 19,895 El Moro (GoldCorp) $ 18,551 Telegrapho (Antofagasta) $ 18,472 Tampakan (Xstrata) $ 18,400 Toromocho (Chinalco) $ 17,325 Oyu Tolgoi (Ivanhoe) $ 16,602 Las Bambas (Xstrata) $ 15,759 Salobo (Vale) $ 15,514 Los Bronces (Anglo Amer.) $ 15,474 Cerro Verde (Freeport) $ 15,470 Ministro Mina Hales (Codelco) $ 15,435 Quebrada Blanca (Teck) $ 15,000 Canariaco (Candente) $ 14,672 Quellaveco (Anglo Amer.) $ 14,667 Haquira (FQM) $ 14,290 Rio Blanco (Zijin) $ 13,611 Antamina (BHP) $ 11,550 Antapaccay (Xstrata) $ 10,794 Galeno (Minmetals) $ 10,696 Sentinel (FQM) $ 9,079 Buenavista DC (South. Cop) $ 8,061 Konkola Deep (Vedanta) $ 6,130 Cumulative Production (paid kt Cu) Source: Brook Hunt, equity research estimates. 38
  • 39.
    Agreement to Disposeof DRC Assets • Agreement with ENRC to dispose of all residual claims and assets • Total consideration of $1.25B – consisting of: – $750M payable on closing – $500M three-year promissory note with a 3% interest coupon • Condition of closing – FQM, ENRC and DRC government will settle all disputes relating to the companies beings sold, their assets and operations in the DRC, and – FQM. ENRC and DRC government will be releasing one another in respect of all claims and judgments related to the foregoing or to any other matter arising in the DRC on or before the date of closing • Transaction closing expected on or before February 29, 2012 39
  • 40.
    A Rapidly GrowingMining & Metals Company • Unique core technical strength behind the strong track record of value creation • Existing operations provide a solid platform to support growth • Strong financial position and cash flow • ~$5 billion investment in growth over 2012 – 2016 to significantly increase copper and nickel production • Growth program expected to position First Quantum as the world’s 6th largest copper producer and a top ten nickel producer 40
  • 41.
    A Rapidly Growing Metals & Mining Company www.first-quantum.com TSX: FM LSE: FQM LuSE: FQMZ February 2012 1
  • 42.
    Corporate Profile Stock exchange listings & symbols – (S&P/TSX 60 Index) TSX: FM LSE: FQM LuSE: FQMZ Shares issued and outstanding 476.3 million Fully diluted 476.3 million 52-week share price range C$29.60 – C$12.60 Recent share price – February 17, 2012 C$22.24 Market capitalization – $ millions C$11.4 billion Average daily trading volume - shares 1.6 million Dividend paid in regards to year 2010 – per share C$0.80 US=36%; UK=26%; Geographic breakdown of institutional shareholders Canada=23%; other=15% 42
