SlideShare a Scribd company logo
INTERNSHIP REPORT
ON
MULTISTOREY RESIDENTIAL
BUILDING CONSTRUCTION
(29-08-2023 TO 12-09-2023)
TAKEN AT
NAGPUR INTEGRATED TOWNSHIP
PVT. LTD.
PLOT NO. 2, SECTOR-21, MIHAN, DE-NOTIFIED SEZ,
KHAPRI(RLY), NAGPUR RURAL 441108,(M.H.)
SUBMITTED TO:- SUBMITTED BY:-
Prof. RAJESH CHAUHAN SIR PRANJAL SINGH PARIHAR
HEAD OF DEPARTMENT B.E. VIITH
SEMESTER
CIVIL ENGINEERING CIVIL ENGINEERING
ROLL NO.:- 20302013
ENROLLMENT NO.:- V20R538290001
SCHOOL OF ENGINEERING & TECHNOLOGY
VIKRAM UNIVERSITY
UJJAIN (M.P.) 456010
SESSION:- (2023-2024)
SCHOOL OF ENGINEERING & TECHNOLOGY
VIKRAM UNIVERSITY
UJJAIN (M.P.)
SESSION:- (2023-2024)
CERTIFICATE
This is to certify that the report of internship entitled “ MULTISTOREY
RESIDENTIAL BUILDING CONSTRUCTION” submitted to Head of
department, Civil Engineering, School of Engineering & Technology, Vikram
University, Ujjain (M.P.) by Pranjal Singh Parihar, B.E. VIIth
Sem, Civil
Engineering, required for the fulfilment of practical and viva voice of
internship.
INTERNAL EXAMINER EXTERNAL EXAMINER
ACKNOWLEDGEMENT
I take this opportunity to extend my gratitude to IJM INDIA
INFRASTRUCTURE PVT. LTD. as well as TEAM UNIVERSAL INFRATECH
PVT. LTD for providing me an unbelievable practical learning experience
during the internship. It was indeed to be a pleasure to be part of such
organization for 15 days.
First and foremost, I would like to thank Mr. VIDYA SAGAR INJETI,
Project Manager, NITPL( for IJM INFRASTRUCTURE) and special
thanks to Mr. MAHESH DESAI, Project Manager (for TEAM
UNIVERSAL) and Mr. TEJRAM GOSWAMI, Engineer – Projects, and all
others site engineer and lab engineer, who supported and helped me
throughout the internship and for giving me nice industrial experience.
Secondly, I am no less grateful to other employees and members of the
department for their kind co-operation and spontaneous response.
Last but not the least, I express my gratitude towards my college faculty
Prof. Rajesh Chauhan Sir (HOD), Prof. Sachin Sironiya Sir, Prof.
Chetan Gurjar Sir, Prof. Mohit Prajapati Sir as their guidance is never
forgettable and for sharing their knowledge, helping me and gave me
inspiration to complete the internship program successfully.
PRANJAL SINGH PARIHAR
B.E. VIITH
SEM
CIVIL ENGINEERING
ABSTRACT
The internship program is designed to provide students engaged in a
field experience within opportunity to share their insight, to explore the
links between students’ academic preparation and their field work, and to
assist participants in developing and carrying out the major research
project which will serve culminate their internship experience.
An internship is a period of work experience offered by an organization
for a limited period of time. Once confined to medical graduates, the term
is now used for wide range of placements in business, non-profit
organization and government agencies. They are undertaken by students
and graduates looking to gain relevant skills and experience in a particular
field. Employers benefit from these placements because they often recruit
employees from their interns, who have known capabilities, thus saving
time and money in the long run.
Typically, an internship consists of an exchange of service for experience
between the intern and the organization. Internship are used to
determine if the interns still have an interest in that field after the real-life
experience. In addition, an internship can be used to create a professional
network that can assist with letters of recommendation or lead to future
employment opportunities. The benefit of brining an intern into full-time
employment is that they are already with the company, their position, and
they typically need to no training.
COMPANY PROFILE
IJM INDIA INFRASTRUCTURE PVT. LTD
IJM (India) Infrastructure Limited (IJMII) is a subsidiary company of IJM
Corporation Berhad, with its Group Headquarters at Kuala Lumpur, Malaysia.
It is one of the world's leading companies in infrastructure, construction,
property, plantation and industry for the last 38 years of operations.
IJMII, incorporated in 1998, is a pioneer in highway infrastructure, commercial
and residential construction with its India operations headquartered at
Hyderabad. IJMII has been delivering one sterling performance after another
in its operations in India and has many firsts to its credit.
IJMII has Extensive experience in Highways & Bridges and Properities:
• Built over 5500 lane Km(1500+ Route Kms) of highways and 20Km of
urban rail projects.
• 20.2 Million Sq.ft of Prime Residential/Commercial developemnt.
IJMII has been actively participating in the high growth opportunities offered
by Indian Infrastructure Industry, more specifically in the construction sector.
IJMII's main thrust is in construction and upgrading of highways and property
development including world class townships and commercial buildings using
modern technology and equipment.
IJMII completed India's first flagship Expressway Project - The Mumbai Pune
Expressway from Kon to Chowk in April 2000. One of the more recent projects
completed by IJMII in 2020 is the Dewas Bypass Road Project (Madhya
Pradesh).
IJMII has also delivered world-class integrated townships including Rain tree
Park (Malaysian Township) Kukatpally,Hyderabad, Raintree Park Dwaraka
Krishna Township Phase 1, in Mangalagiri, Guntur. First City Residential
Township Project, Nagpur is currently underway.
The Group Company IJM Corporation Berhad, whose core competency is
construction, is one of Malaysia's largest and most diversified construction
groups, with world-wide presence with specialization in the areas of
construction, property development, manufacturing, quarrying, plantation
and international ventures. Its current operations are spread over Malaysia,
India, Australia, Argentina, Chile, China, Myanmar, Singapore and Vietnam.
IJM is a highly quality conscious company with the motto of "Excellence
Through Quality".
TEAM UNIVERSAL INFRATECH PVT. LTD (An IJM Group
Company)
Team group emerged in the year 2007 to provide services to construction &
infrastructure industry. We are a team of Exceptional Engineers and Managers, who
believe in constantly pushing limits and delighting our clients with our exceptional
delivery capabilities and state of the art technology.
Since inception we are involved in building Commercial, Residential complex, Housing,
Roads, Railways, Airports. We don´t consider construction as just a business, but we
provide professional Service with Passion.
Today, the Team Group keep exploring new horizons in infrastructure development,
housing, townships, real estate development & turnkey construction services.
The professional individuals has grouped under flagship of Team Universal having
registered office at Hyderabad, India, consists team of multicultural, multifaceted &
versatile committed individuals & advisors who share core values & are highly focused
on leveraging their complementary skills for the benefit of clients.
The Team is capable of handling multiple projects, uniquely complex, with passion to
excel. We are on the way to achieve our bold vision of being among top service
providers in construction industry within next three-five years.
Quality has been our prime objective all through and it will remain as we believe in
long term relation with our clients. Efficient project management professionals &
Enterprise Resource Planning tools in the right hands help us to keep up the pace
while we optimize the utilization of resources and maintain transparency.
The reason that makes us feel proud and stand out is our ethics and we think plan in
unison and therefore deliver product with quality.
We believe in importance of maintaining reputation build over past years reinforcing
our motto at Team Service with Passion.

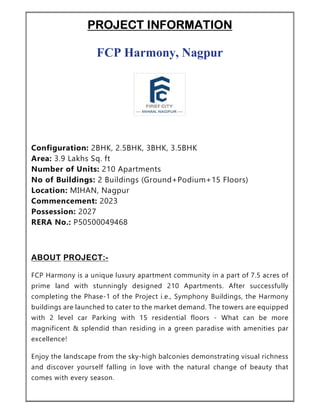

PROJECT INFORMATION
FCP Harmony, Nagpur
Configuration: 2BHK, 2.5BHK, 3BHK, 3.5BHK
Area: 3.9 Lakhs Sq. ft
Number of Units: 210 Apartments
No of Buildings: 2 Buildings (Ground+Podium+15 Floors)
Location: MIHAN, Nagpur
Commencement: 2023
Possession: 2027
RERA No.: P50500049468
ABOUT PROJECT:-
FCP Harmony is a unique luxury apartment community in a part of 7.5 acres of
prime land with stunningly designed 210 Apartments. After successfully
completing the Phase-1 of the Project i.e., Symphony Buildings, the Harmony
buildings are launched to cater to the market demand. The towers are equipped
with 2 level car Parking with 15 residential floors - What can be more
magnificent & splendid than residing in a green paradise with amenities par
excellence!
Enjoy the landscape from the sky-high balconies demonstrating visual richness
and discover yourself falling in love with the natural change of beauty that
comes with every season.
The Harmony towers are designed with ample natural ventilation with open
area on 3 sides and all along with central space dedicated to more features like
clubhouse, Leisure Park (Miyawaki Forest), Party Lawn with deck, Box Cricket
Pitch etc.
All blocks are aligned to true north and designed as per Vastu. At present, 2
buildings i.e Harmony 1 & 6 are under construction and will be ready for
possession by 2027.
REVIEW OF TASKS PERFORMED
The Internship work has been carried out at NITPL after the completion of 6th
semester for the duration of 15 days.
The following table shows the day wise Internship Training sessions.

DATE COVERED TOPICS
Day 1
29-08-2023

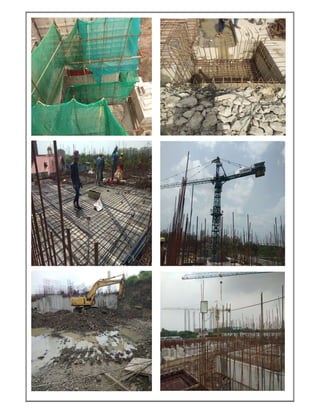

Overall site visit and gathered information about the project.
Day 2
30-08-2023

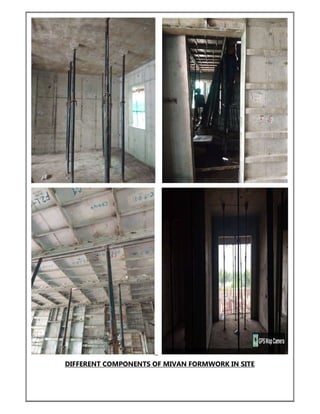

Introduction about the components of Mivan Formwork
Day 3
31-08-2023
Over view of construction plans of the project
Day 4
01-09-2023

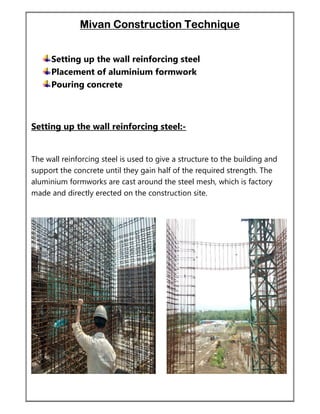

Setting up the wall reinforcement steel
Day 5
02-09-2023
Inspection of the wall reinforcement steel
Day 6
03-09-2023
Setting up the slab reinforcement steel and inspection on
electrical and plumbing connection
Day 7
04-09-2023

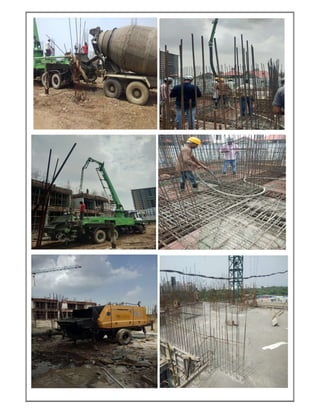

Placement of aluminium formwork
Day 8
05-09-2023
Inspection of the placed aluminium formwork and checking the
dimensions
Day 9
06-09-2023

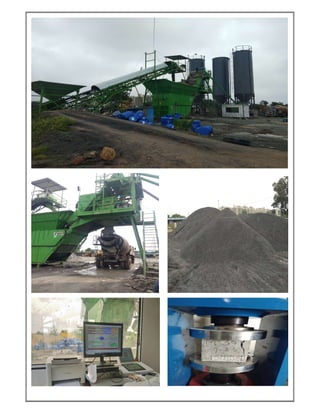

Visited near to Batching plant and materials feed in batching
plant
Day 10
07-09-2023
Operation of batching plant
Day 11
08-09-2023
Different tests performed in lab
Day 12
09-09-2023
Construction of domestic water supply tank
Day 13
10-09-2023
Casting of stair case and steel binding and casting of raft
foundation
Day 14
11-09-2023

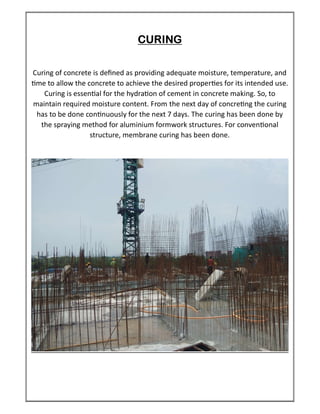

Learnt about the curing process
Day 15
12-09-2023

Marking to place the bars by using total station
SITE PLAN & FLOOR PLAN

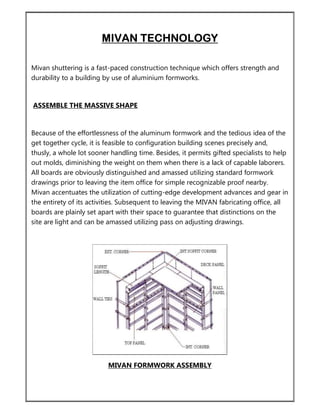

MIVAN TECHNOLOGY

Mivan shuttering is a fast-paced construction technique which offers strength and
durability to a building by use of aluminium formworks.
ASSEMBLE THE MASSIVE SHAPE
Because of the effortlessness of the aluminum formwork and the tedious idea of the
get together cycle, it is feasible to configuration building scenes precisely and,
thusly, a whole lot sooner handling time. Besides, it permits gifted specialists to help
out molds, diminishing the weight on them when there is a lack of capable laborers.

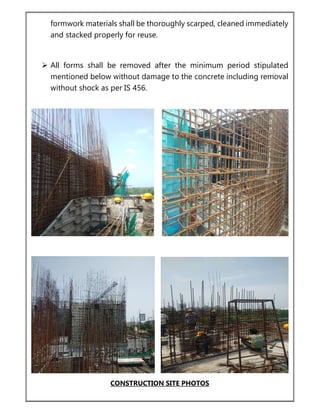

All boards are obviously distinguished and amassed utilizing standard formwork
drawings prior to leaving the item office for simple recognizable proof nearby.
Mivan accentuates the utilization of cutting-edge development advances and gear in
the entirety of its activities. Subsequent to leaving the MIVAN fabricating office, all
boards are plainly set apart with their space to guarantee that distinctions on the
site are light and can be amassed utilizing pass on adjusting drawings.
MIVAN FORMWORK ASSEMBLY
WORK CYCLE
Mivan is a method of scheduling and maintaining work cycles produced by other

related building styles, such as steel-reinforced solid formations, in which the work
cycle follows a specific assembly. After that, the sections and are placed at the stage
level. This exercise takes 7 to 10 hours to complete. In 7 hours, the kickers and
outdoor suite are complete. In 6 hours, the wall shutters will be built. The main
reinforcements took 10 to 12 hours. Finally, the bob electrical conduit is fixed, and
concrete is poured. This is a well-synchronized cycle of 7 days from 10 to 12 hours.
Cementing is then left until the solids have taken quality before the next cycle
begins and the molds are assembled from side to side in a quick and easy manner.
All panels are clearly marked when leaving the Mivan processing facility, ensuring
that they can be easily identified and installed nearby.
The regimen usually follows a four-day cycle
Day 1: The first task is to install the vertical reinforcement bars and part of the entire
floor or floor on one side of the vertical formwork.
Day 2: The second task is to create the second part of the vertical formwork as well
as pouring the concrete.
Day 3: Installation of floor slab reinforcement bars, walls and casting panels.
Day 4: Column-shaped work boards are removed after 24 hours, kept in place for 7
days and formwork is kept for 2.5 days.

Formwork – Components
The plate, which is important for an aluminium bar welded to an aluminium sheet, is
the principle part of the shape. The outcome is a lightweight board with a high
extent to weight proportion, which avoids the substantial marginally under tension.
Boards can be made to any measure or shape to address the issues of explicit
applications. The boards are made of high-strength aluminium amalgam and have a
4mm thick facade plate and 6mm thick ribbed sponsorship to build up it. Mivan's
exceptional offices in Europe and Southeast Asia produce boards. Whenever they
are constructed, they go through a preliminary erection cycle to preclude any
dimensional or positional issues. The most commonly used components in
construction are listed below.
Wall Components:-
Wall Pannel
Make a divider face. It is a sheet of aluminium that is appropriately
managed to fit the specific size of the divider.
WALL PANNEL
Rocker
It is a supporting component to the divider. It is a L-molded plate
with adjustable openings for the heel screw.
ROCKER
Kicker
It frames the divider face at the highest point of the boards and
goes about as an edge to help.
KICKER
Stub
Pin It helps in joining two divider boards. It helps in joining two
joints.
STUB & PINS
Beam Components:-
Beam Side Panel
Shaped on the shafts. It has a rectangular construction and is
sliced to the size of a shaft.
BEAM SIDE PANNEL

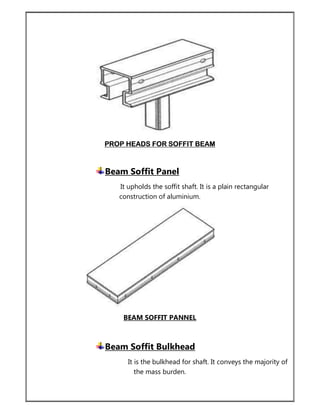

Prop Heads for Soffit Beam
It frames an extraordinary pillar and has an Angular head that
permits the molds to be effectively dismantled.
PROP HEADS FOR SOFFIT BEAM
Beam Soffit Panel
It upholds the soffit shaft. It is a plain rectangular
construction of aluminium.
BEAM SOFFIT PANNEL
Beam Soffit Bulkhead
It is the bulkhead for shaft. It conveys the majority of
the mass burden.
BEAM SOFFIT BULKHEAD
Deck Components:-
Deck Board
This structures a flat surface for the chunk shape. Intended
for appropriate labour security.
DECK BOARD
Deck Prop
Structures an Angular swagger head that upholds the deck and
conveys the heap on the deck plate.
DECK PROP
Prop Length
It is the length of the prop. It relies on the length of the
section.
PROP LENGTH
Deck mid – Beam
It upholds the center bit of the shaft. It holds the substantial.
DECK MID-BEAM
Other Components:-
Internal Soffit Corner
Structures an upward interior point between dividers, supports, pieces and
equalinear moldings between dividers, brace boards and shaft support.
INTERNAL SOFFIT CORNER
External Soffit Corner
Outside points structure the upward outside point between the dividers and/or shaft
faces and the level outside corners between the divider/pillar face and the outside of
the boards.
EXTERNAL SOFFIT CORNER
External Corner
The outside corner interfaces ver cal or flat structure
cooperate at right points.
EXTERNAL CORNER

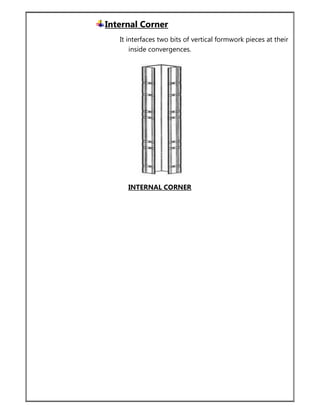

Internal Corner
It interfaces two bits of vertical formwork pieces at their
inside convergences.
INTERNAL CORNER
DIFFERENT COMPONENTS OF MIVAN FORMWORK IN SITE

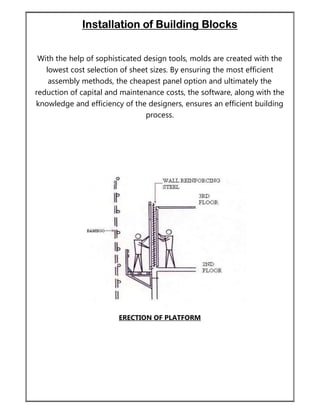

Installation of Building Blocks
With the help of sophisticated design tools, molds are created with the
lowest cost selection of sheet sizes. By ensuring the most efficient
assembly methods, the cheapest panel option and ultimately the
reduction of capital and maintenance costs, the software, along with the
knowledge and efficiency of the designers, ensures an efficient building
process.
ERECTION OF PLATFORM
STRIKING OF FORMWORK
REMOVAL OF KICKER

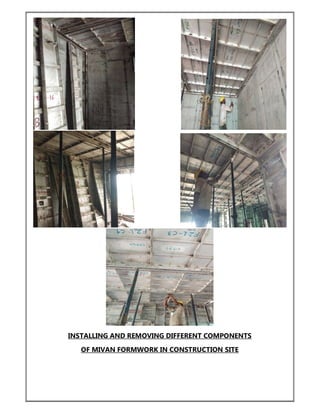

INSTALLING AND REMOVING DIFFERENT COMPONENTS
OF MIVAN FORMWORK IN CONSTRUCTION SITE
Mivan Construction Technique
Setting up the wall reinforcing steel
Placement of aluminium formwork
Pouring concrete
Setting up the wall reinforcing steel:-
The wall reinforcing steel is used to give a structure to the building and
support the concrete until they gain half of the required strength. The
aluminium formworks are cast around the steel mesh, which is factory
made and directly erected on the construction site.
SHEAR WALL AND MIVAN WALL IN CONSTRUCTION SITE
Reinforcement
 Steel is the major part of construction; reinforcement provides
tensile strength for the concrete. Although steel is manufactured
somewhere else but like batching plant to make concrete there is a
steel yard also to cut the steel into the specified shapes. For proper
administrating the construction and fast progress of the work “Bar
Bending Schedule” generally called BBS. Every steel rod has a
number which is clearly mentioned in the RC drawings. BBS is made
for each drawing and shall be handed over to the sub-contractors to
cut the steel according to it. There will be monthly quality check of
the steel 1 sample is taken and sent for third party testing.
 BBS contains all the parts of the steel for the respective structural
member. It has different structural members and the all types of
steel rods with respective shapes. Those steel rods are after been cut
and bent into the respective shapes are labelled with respective
number so that it will be easy for the workmen to pick them up for a
member and tie it up fast without an extra cross checking.
 Lap-length is the length that one bar should be tied to another in
case of extending it and it varies with the grade of concrete. The
development length for M40 it should be greater than equal to
36xdiameter, M30 it should be greater than equal to 46xdiameter
and for M25 it should be greater than equal to 49xdiameter.
 As there are grades in concrete there are different types of steels
the one used here is Fe500 which means 500 is the minimum yield
stress in N/mm2
of the steel and it is mentioned in general notes
that everywhere fy(Y) refers to Fe500. In our site HYSD bars are used.
The works such as bending the bars and making stirrups are handed
over to sub-contractors. The sub-contractors are given Bar Bending
Schedule and seeing that they will cut bend and label the steel into
the respective dimensions. There is a separate machine for stirrups
because one will be needing many stirrups in a construction site.
Placement of aluminium formwork:-
Along the wall reinforcing steel, prefabricated room sized walls and floor
slabs are erected. These aluminium alloy slabs are accurately made and
are easy to handle. Spaces for windows, ducts, doors and other features
such as staircases, pannels and sunshade(chajjas) are also integrated in
these structures. The forms are joint together using the pin and wedge
system, which can be dismantled quickly after the concrete structure is
made.
The sequence of orders and method of removal of formwork are as
follows:
 Shuttering forming the vertical faces of walls, beams and column
sides should be removed in the above order first, as they bear no
load but only retain the concrete.
 Shuttering forming soffit of slabs should be removed next.
 Shuttering forming soffit of beams, girders or other heavily loaded
shuttering should be removed in the end.
METHOD FOR FORM WORK:-
 Formwork Drawings
Site will be provided with a set of formwork drawings which entailed the
followings: -
Shell Plan Layout, Formwork layout drawings, Elevations and sections
drawings indicating the location of formwork panels and component,
Typical Fixing Detail drawings and location of Box outs and Transfer Box
out drawings for transfer of Formwork, etc.
 Pre-Check
 Check if the shutters are properly cleaned by removing the concrete/
mortar and protruding nails.
 Formwork shall be made to the exact dimensions within the
permissible tolerances as mentioned below.
 Required thickness and quality of steel conforming to IS 6461 shall be
used to meet the requirements of design and surface finish.
 For beam bottom & sides, proper size of steel at required spacing shall
be provided to take the design loads/ pressure considering sleeves,
conduit anchors & inserts.
PRE CHECKING OF ALUMINIUM FORMWORK
 Erection of formwork
 Sufficiently rigid and tight to prevent the loss of grout or mortar
from the concrete.
 Capable of providing concrete of the correct shape and surface
finish within the specified tolerance limits.
 Soffits forms capable of imparting a camber if required.
 The formwork may be of timber, plywood, steel, plastic or concrete
depending upon the type of finish specified.
 Erect staging/shuttering as per drawing/sketches in such a way that
de-shuttering can be done easily including provision for re-
propping, if planned.
 Check the location, line, level, plumb and dimensions of the
formwork to ensure that the deviations are within the permissible
limits.
 Provide bracing at proper places & intervals as specified by the
manufacturer or as per formwork scheme to take care of lateral
loads.
 Apply mould oil/other coatings as release agents before
reinforcement steel is placed.
 Wire ties passing through beams, columns and walls shall not be
allowed. In their place bolts passing through sleeves shall be used.
For liquid retaining structures, sleeves shall not be provided for
through bolts.
 Check all the shutters are properly aligned and fixed firmly with
required lateral supports and ties.
 Check all the spanning members have proper bearing at the
supports.
 Forms shall be thoroughly cleaned of all dirt, mortar and other
matters such as metals, blocks, saw dust and foreign materials
before concreting if required through clean-out openings.
 Check all the gaps/openings are properly closed to avoid leakages.
 Check all the inserts and openings are exactly placed as per the
drawings.
 In case of leakages, bulging and sagging immediate actions shall be
taken by tightening wedges or adjusting by jacks which must be
done before the concrete takes its initial set.
 Wedges or jacks shall be secured in position after the final check of
alignment.
 Removal of Forms
 Formwork components shall not be dropped but shall be lowered
without damage to the components and structures. All the removed
formwork materials shall be thoroughly scarped, cleaned immediately
and stacked properly for reuse.
 All forms shall be removed after the minimum period stipulated
mentioned below without damage to the concrete including removal
without shock as per IS 456.
CONSTRUCTION SITE PHOTOS
Batching Plant
A Concrete Batching Plant is a machine to manufacture Concrete from its
ingredients viz Cement, Crushed Stone, Sand, Water and Admixture
Chemicals. The word Batching Plant comes from the word "Batch", which
essentially means that concrete is manufactured in measured bathes inside
a Concrete Batching Plant.
Material feeding:-
 Cement OPC 53 Grade
 Fly Ash
 Aggregate 10mm
 Aggregate 20mm
 Crushed Stone Dust
 Sand
 Water
 Poly Vinyl Plasticizers
Grade Of Concrete Used In Construction:-
 M20 for PCC work
 M30 for Slab Casting
 M40 for Shear Wall and Foundation.
Concrete Strength Test Result:-
Grade Of
Concrete
7 Days 14 Days 28 Days
M20 22.15 N/mm2 27.83 N/mm2 34.59 N/mm2
M30 34.63 N/mm2 42.34 N/mm2 60.13 N/mm2
M40 42.29 N/mm2 48.22 N/mm2 55.72 N/mm2
Pouring Concrete:-
After casting the forms, high-quality concrete is poured. This concrete
takes the form and shape of the cast, which is later removed to make way
for a structure made entirely of cement concrete supported by wall
reinforcing steel. The aluminium forms can be reused at least 250 times,
resulting in minimum waste from the construction site Ensure site
coordinators are available and on stand-by during the concreting process.
Always ensure that concrete pouring is distributed evenly throughout the
wall sections before commencing to cast the slab level areas. This is to
prevent loading pressure on the formwork panels due to uneven casting.
Recheck the areas whenever cement slurry leakage is noted to determine
the cause of it. Remedy work should be done immediately to ensure the
concreting process is not affected. During concreting, always ensure that
immediate step is taken to remove/clean all the excess concrete that is
stuck on the back of the formwork panels. Non removal will result in the
formwork panels getting too heavy and also the scrapping task after the
concrete has dried up becomes more tedious.
CURING
Curing of concrete is defined as providing adequate moisture, temperature, and
me to allow the concrete to achieve the desired proper es for its intended use.
Curing is essen al for the hydra on of cement in concrete making. So, to
maintain required moisture content. From the next day of concre ng the curing
has to be done con nuously for the next 7 days. The curing has been done by
the spraying method for aluminium formwork structures. For conven onal
structure, membrane curing has been done.
Advantages of Mivan Technology
 The time frame for the construction is drastically reduced and is
more advantages and sustainable for fast track project.
 As the walls are casted along with slab as monolithic, the time for
construction of walls and plaster is reduced.
 Wall thickness is reduced and hence the dead load is reduced and
economically the structure and foundation can be designed.
 These structures result unnatural high strength against natural
disastrous due to its unique style monolithic structure as compared
to the conventional.
 Number of activities can be reduced.
 The form (Mivan Shuttering) is a self-aligning and locking system
which ensures dimensional accuracy with less manpower.
Disadvantages of Mivan Technology
 Its initial cost and setup time is higher than conventional formwork.
 Less Scope of modification or alteration.
 Visible finishing lines.
 Expensive in construction.
 Can have contraction cracks.
FOUNDATION
Foundation is one of the essential parts of the structure. It is defined as
that part of the structure that transfers the load from the structure
constructed on it as well as its weight over a large area of soil in such a
way that the amount does not exceed the ultimate bearing capacity of the
soil and the settlement of the whole structure remains within a tolerable
limit. Foundation is the part of a structure on which the building stands.
The solid ground on which it rests is known as the foundation bed.
Raft or Mat Foundation:-
Raft or Mat foundations are used where other shallow or pile foundations
are not suitable. It is also recommended in situations where the bearing
capacity of the soil is inadequate, the load of the structure is to be
distributed over a large area, or the structure is subjected continuously to
shocks or jerks.
A raft foundation consists of a reinforced concrete slab or T-beam slab
placed over the entire area of the structure. In this type, the whole
basement floor slab acts as the foundation. The total load of the structure
is spread evenly over the entire area of the structure. This is called a raft
because, in this case, the building seems like a vessel that floats on a sea of
soil.
Raft foundations are economic when:-
 The soil is weak and the load has to be spread over a large area.
 The structure includes a basement.
 Columns are closely placed.
 Other kinds of foundations are not feasible.
 Differential settlement is to be prevented.

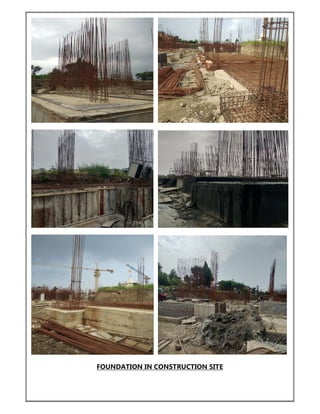

FOUNDATION IN CONSTRUCTION SITE

TOTAL STATION
A total station is an electronic/optical instrument used in
modern surveying and building construction that uses electronic transit
theodolite in conjunction with electronic distance meter (EDM). It is also
integrated with microprocessor, electronic data collector and storage
system
The instrument is used to measure sloping distance of object to the
instrument, horizontal angles and vertical angles. This Microprocessor unit
enables for computation of data collected to further calculate the
horizontal distance, coordinates of a point and reduced level of point.
Data collected from total station can be downloaded into
computer/laptops for further processing of information.
DISTANCE MEASUREMENT:-
1. Setting of the Atmospheric Correction When setting the atmospheric
correction, obtain the correct value by measuring the temperature and
pressure.
2. Setting of the Correction for Prism Constant Topcon’s prism constant
value is 0. Set correction for prism at 0. If the prism is of another
manufacture, the appropriate constant shall be set beforehand.
3. Distance Measurement (Continuous Measurement)
Make sure the mode displays angle measurement.
Benefits of this Internship
 Practical skills are improved.
 Communication skills are developed.
 Learnt different types of Construction works and its uses.
 Learnt to execute the work as planned.
More Construction Site Images
CONCLUSION
It has been a remarkable experience in working with IJM
INFRASTRUCTURE & TEAM UNIVERSAL INFRATECH PVT. LTD. in the
project “NAGPUR INTEGRATED TOWNSHIP PVT. LTD. (First City
Harmony Buildings 1-6)”, where I could witness all the phases of
construction for 15 days in Nagpur. I have been exposed to all the phases
of the site where I have learned many useful things to develop my intuition
and gained knowledge about almost all of the aspects. I have witnessed
different challenges in such a short time period. The caring accommodation
in the office shows the true experience and kindness of every employee
here. I am very thankful to all of the employees here for guiding me through
a wonderful life experience with a positive composure. I am sure that this
experience would guide me in life and drive me towards my goals.
---------------x---------------

More Related Content

What's hot

A UHPC (ultra high performance concrete) presentation projects.
A UHPC (ultra high performance concrete) presentation projects.A UHPC (ultra high performance concrete) presentation projects.
A UHPC (ultra high performance concrete) presentation projects.
Nolan Mayrhofer

Prefabrication​ structure ppt
Prefabrication​ structure pptPrefabrication​ structure ppt
Prefabrication​ structure ppt
AbhishekM45

Ppt summer presentation on finishing Of Police Station Construction Site
Ppt summer presentation on finishing Of Police Station Construction SitePpt summer presentation on finishing Of Police Station Construction Site
Ppt summer presentation on finishing Of Police Station Construction Site
Alok Mishra

High Performance Concrete
High Performance ConcreteHigh Performance Concrete
High Performance Concrete
Ahsan Rabbani

Pile foundations Case Study Delhi Metro Site Visit
Pile foundations Case Study  Delhi Metro Site VisitPile foundations Case Study  Delhi Metro Site Visit
Pile foundations Case Study Delhi Metro Site Visit
Mohd Kashif

Autoclaved Aerated Concrete Blocks
Autoclaved Aerated Concrete BlocksAutoclaved Aerated Concrete Blocks
Autoclaved Aerated Concrete Blocks
Thaju Zaman

High strength concrete
High strength concreteHigh strength concrete
High strength concrete
Dr K M SONI

Construction of diaphragm wall
Construction of diaphragm wallConstruction of diaphragm wall
Construction of diaphragm wall
Ghanashyam Prajapati

Rice husk ash based geopolymer concrete
Rice husk ash based geopolymer concreteRice husk ash based geopolymer concrete
Rice husk ash based geopolymer concrete
Shaswat K. Das

Civil engineering - thumb rule
Civil engineering - thumb ruleCivil engineering - thumb rule
Civil engineering - thumb rule
BenAdem1

Construction industry
Construction industryConstruction industry
Construction industry
Advait Bhobe

civil enginnering industrial training report
civil enginnering industrial training report civil enginnering industrial training report
civil enginnering industrial training report
KRISHNA MURARI

Shear wall ppt
Shear wall ppt Shear wall ppt
Shear wall ppt
Akash Pandey

Internship review (Civil Engineering)
Internship review (Civil Engineering)Internship review (Civil Engineering)
Internship review (Civil Engineering)
Syeda Nusrath Fathima

Updated_Work_Profile_29-09-15
Updated_Work_Profile_29-09-15Updated_Work_Profile_29-09-15
Updated_Work_Profile_29-09-15
Chandan Singh

Reduction of cost in construction
Reduction of cost in constructionReduction of cost in construction
Reduction of cost in construction
Saravana murthy

LOW COST HOUSING
LOW COST HOUSINGLOW COST HOUSING
LOW COST HOUSING
preeti patil

specification of Rcc
specification of Rccspecification of Rcc
specification of Rcc
Prabhat chhirolya

Total Quality Management In Construction
Total Quality Management In ConstructionTotal Quality Management In Construction
Total Quality Management In Construction
Mohammed EL Bakri EL Beeli

Special Concreting Techniques
Special Concreting Techniques Special Concreting Techniques
Special Concreting Techniques
GAURAV. H .TANDON

What's hot (20)

A UHPC (ultra high performance concrete) presentation projects.
A UHPC (ultra high performance concrete) presentation projects.A UHPC (ultra high performance concrete) presentation projects.
A UHPC (ultra high performance concrete) presentation projects.

Prefabrication​ structure ppt
Prefabrication​ structure pptPrefabrication​ structure ppt
Prefabrication​ structure ppt

Ppt summer presentation on finishing Of Police Station Construction Site
Ppt summer presentation on finishing Of Police Station Construction SitePpt summer presentation on finishing Of Police Station Construction Site
Ppt summer presentation on finishing Of Police Station Construction Site

High Performance Concrete
High Performance ConcreteHigh Performance Concrete
High Performance Concrete

Pile foundations Case Study Delhi Metro Site Visit
Pile foundations Case Study  Delhi Metro Site VisitPile foundations Case Study  Delhi Metro Site Visit
Pile foundations Case Study Delhi Metro Site Visit

Autoclaved Aerated Concrete Blocks
Autoclaved Aerated Concrete BlocksAutoclaved Aerated Concrete Blocks
Autoclaved Aerated Concrete Blocks

High strength concrete
High strength concreteHigh strength concrete
High strength concrete

Construction of diaphragm wall
Construction of diaphragm wallConstruction of diaphragm wall
Construction of diaphragm wall

Rice husk ash based geopolymer concrete
Rice husk ash based geopolymer concreteRice husk ash based geopolymer concrete
Rice husk ash based geopolymer concrete

Civil engineering - thumb rule
Civil engineering - thumb ruleCivil engineering - thumb rule
Civil engineering - thumb rule

Construction industry
Construction industryConstruction industry
Construction industry

civil enginnering industrial training report
civil enginnering industrial training report civil enginnering industrial training report
civil enginnering industrial training report

Shear wall ppt
Shear wall ppt Shear wall ppt
Shear wall ppt

Internship review (Civil Engineering)
Internship review (Civil Engineering)Internship review (Civil Engineering)
Internship review (Civil Engineering)

Updated_Work_Profile_29-09-15
Updated_Work_Profile_29-09-15Updated_Work_Profile_29-09-15
Updated_Work_Profile_29-09-15

Reduction of cost in construction
Reduction of cost in constructionReduction of cost in construction
Reduction of cost in construction

LOW COST HOUSING
LOW COST HOUSINGLOW COST HOUSING
LOW COST HOUSING

specification of Rcc
specification of Rccspecification of Rcc
specification of Rcc

Total Quality Management In Construction
Total Quality Management In ConstructionTotal Quality Management In Construction
Total Quality Management In Construction

Special Concreting Techniques
Special Concreting Techniques Special Concreting Techniques
Special Concreting Techniques

Similar to Internship file for summer training

Final Project
Final ProjectFinal Project
Final Project
Er Naveen Kumar

Civil engineering internship report
Civil engineering internship reportCivil engineering internship report
Civil engineering internship report
Md Mohsin Mohsin

recruitment and selection policy of reliance
recruitment and selection policy of reliancerecruitment and selection policy of reliance
recruitment and selection policy of reliance
bunnysharma

RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf
RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdfRECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf
RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf
Vikas Gupta

pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf
pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdfpdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf
pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf
zeeshansami3

RAVIKUMAR CV updated 08092016
RAVIKUMAR CV updated 08092016RAVIKUMAR CV updated 08092016
RAVIKUMAR CV updated 08092016
ORUGANTI RAVI KUMAR

REPORT-NIRUPAMA
REPORT-NIRUPAMAREPORT-NIRUPAMA
REPORT-NIRUPAMA
Nirupama Bakshi

full details about building construction & process
full details about building construction & process full details about building construction & process
full details about building construction & process
karthikachanta1

“DESIGN AND DEVELOPMENT OF FIXTURE FOR FIXING BEARING IN CRANK-CASE
“DESIGN AND DEVELOPMENT OF FIXTURE FOR  FIXING BEARING IN CRANK-CASE“DESIGN AND DEVELOPMENT OF FIXTURE FOR  FIXING BEARING IN CRANK-CASE
“DESIGN AND DEVELOPMENT OF FIXTURE FOR FIXING BEARING IN CRANK-CASE
Atmiya Institute of Technology and Science (Past)

The accurates
The accuratesThe accurates
The accurates
Rakesh Patro

Vishwa
VishwaVishwa
L&T DMRC Summer Internship 2017
L&T DMRC Summer Internship 2017 L&T DMRC Summer Internship 2017
L&T DMRC Summer Internship 2017
Sunil Kumar

training report
training reporttraining report
training report
Lilonheart

CEO -Presentation on Engineers day at KIIT
CEO -Presentation on Engineers day at KIITCEO -Presentation on Engineers day at KIIT
CEO -Presentation on Engineers day at KIIT
Anil Kumar Bohra

RESUME DETAILS
RESUME DETAILS RESUME DETAILS
RESUME DETAILS
MANIVANNAN RAMACHARY

Vijay presentation 2016 new
Vijay presentation 2016 newVijay presentation 2016 new
Vijay presentation 2016 new
vijayakumar somu

Asia Bridge Profile
Asia Bridge ProfileAsia Bridge Profile
Asia Bridge Profile
Karthigesu Karuppiah

industrial training report
industrial training reportindustrial training report
industrial training report
Love Kothari

Final Report
Final ReportFinal Report
Final Report
Susom Dutta

Industrial training report
Industrial training report Industrial training report
Industrial training report
Suresh Thakur

Similar to Internship file for summer training (20)

Final Project
Final ProjectFinal Project
Final Project

Civil engineering internship report
Civil engineering internship reportCivil engineering internship report
Civil engineering internship report

recruitment and selection policy of reliance
recruitment and selection policy of reliancerecruitment and selection policy of reliance
recruitment and selection policy of reliance

RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf
RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdfRECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf
RECRUITMENT & SELECTION POLICIES OF RELIANCE By Jai Rane.pdf

pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf
pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdfpdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf
pdfcoffee.com_civil-engineering-summer-training-report--pdf-free.pdf

RAVIKUMAR CV updated 08092016
RAVIKUMAR CV updated 08092016RAVIKUMAR CV updated 08092016
RAVIKUMAR CV updated 08092016

REPORT-NIRUPAMA
REPORT-NIRUPAMAREPORT-NIRUPAMA
REPORT-NIRUPAMA

full details about building construction & process
full details about building construction & process full details about building construction & process
full details about building construction & process

“DESIGN AND DEVELOPMENT OF FIXTURE FOR FIXING BEARING IN CRANK-CASE
“DESIGN AND DEVELOPMENT OF FIXTURE FOR  FIXING BEARING IN CRANK-CASE“DESIGN AND DEVELOPMENT OF FIXTURE FOR  FIXING BEARING IN CRANK-CASE
“DESIGN AND DEVELOPMENT OF FIXTURE FOR FIXING BEARING IN CRANK-CASE

The accurates
The accuratesThe accurates
The accurates

Vishwa
VishwaVishwa
Vishwa

L&T DMRC Summer Internship 2017
L&T DMRC Summer Internship 2017 L&T DMRC Summer Internship 2017
L&T DMRC Summer Internship 2017

training report
training reporttraining report
training report

CEO -Presentation on Engineers day at KIIT
CEO -Presentation on Engineers day at KIITCEO -Presentation on Engineers day at KIIT
CEO -Presentation on Engineers day at KIIT

RESUME DETAILS
RESUME DETAILS RESUME DETAILS
RESUME DETAILS

Vijay presentation 2016 new
Vijay presentation 2016 newVijay presentation 2016 new
Vijay presentation 2016 new

Asia Bridge Profile
Asia Bridge ProfileAsia Bridge Profile
Asia Bridge Profile

industrial training report
industrial training reportindustrial training report
industrial training report

Final Report
Final ReportFinal Report
Final Report

Industrial training report
Industrial training report Industrial training report
Industrial training report

Recently uploaded

一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理
一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理
一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理
nedcocy

Generative AI Use cases applications solutions and implementation.pdf
Generative AI Use cases applications solutions and implementation.pdfGenerative AI Use cases applications solutions and implementation.pdf
Generative AI Use cases applications solutions and implementation.pdf
mahaffeycheryld

Mechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdfMechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdf
21UME003TUSHARDEB

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
shadow0702a

Curve Fitting in Numerical Methods Regression
Curve Fitting in Numerical Methods RegressionCurve Fitting in Numerical Methods Regression
Curve Fitting in Numerical Methods Regression
Nada Hikmah

LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by AnantLLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
Anant Corporation

AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...
AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...
AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...
Paris Salesforce Developer Group

Object Oriented Analysis and Design - OOAD
Object Oriented Analysis and Design - OOADObject Oriented Analysis and Design - OOAD
Object Oriented Analysis and Design - OOAD
PreethaV16

CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS
CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURSCompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS
CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS
RamonNovais6

Software Engineering and Project Management - Software Testing + Agile Method...
Software Engineering and Project Management - Software Testing + Agile Method...Software Engineering and Project Management - Software Testing + Agile Method...
Software Engineering and Project Management - Software Testing + Agile Method...
Prakhyath Rai

Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Sinan KOZAK

SCALING OF MOS CIRCUITS m .pptx
SCALING OF MOS CIRCUITS m                 .pptxSCALING OF MOS CIRCUITS m                 .pptx
SCALING OF MOS CIRCUITS m .pptx
harshapolam10

CEC 352 - SATELLITE COMMUNICATION UNIT 1
CEC 352 - SATELLITE COMMUNICATION UNIT 1CEC 352 - SATELLITE COMMUNICATION UNIT 1
CEC 352 - SATELLITE COMMUNICATION UNIT 1
PKavitha10

22CYT12-Unit-V-E Waste and its Management.ppt
22CYT12-Unit-V-E Waste and its Management.ppt22CYT12-Unit-V-E Waste and its Management.ppt
22CYT12-Unit-V-E Waste and its Management.ppt
KrishnaveniKrishnara1

Properties Railway Sleepers and Test.pptx
Properties Railway Sleepers and Test.pptxProperties Railway Sleepers and Test.pptx
Properties Railway Sleepers and Test.pptx
MDSABBIROJJAMANPAYEL

Engineering Standards Wiring methods.pdf
Engineering Standards Wiring methods.pdfEngineering Standards Wiring methods.pdf
Engineering Standards Wiring methods.pdf
edwin408357

2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf
2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf
2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf
Yasser Mahgoub

一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理
一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理
一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理
upoux

Embedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoringEmbedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoring
IJECEIAES

一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理
一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理
一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理
ecqow

Recently uploaded (20)

一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理
一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理
一比一原版(爱大毕业证书)爱荷华大学毕业证如何办理

Generative AI Use cases applications solutions and implementation.pdf
Generative AI Use cases applications solutions and implementation.pdfGenerative AI Use cases applications solutions and implementation.pdf
Generative AI Use cases applications solutions and implementation.pdf

Mechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdfMechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdf

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...

Curve Fitting in Numerical Methods Regression
Curve Fitting in Numerical Methods RegressionCurve Fitting in Numerical Methods Regression
Curve Fitting in Numerical Methods Regression

LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by AnantLLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant

AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...
AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...
AI + Data Community Tour - Build the Next Generation of Apps with the Einstei...

Object Oriented Analysis and Design - OOAD
Object Oriented Analysis and Design - OOADObject Oriented Analysis and Design - OOAD
Object Oriented Analysis and Design - OOAD

CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS
CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURSCompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS
CompEx~Manual~1210 (2).pdf COMPEX GAS AND VAPOURS

Software Engineering and Project Management - Software Testing + Agile Method...
Software Engineering and Project Management - Software Testing + Agile Method...Software Engineering and Project Management - Software Testing + Agile Method...
Software Engineering and Project Management - Software Testing + Agile Method...

Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024

SCALING OF MOS CIRCUITS m .pptx
SCALING OF MOS CIRCUITS m                 .pptxSCALING OF MOS CIRCUITS m                 .pptx
SCALING OF MOS CIRCUITS m .pptx

CEC 352 - SATELLITE COMMUNICATION UNIT 1
CEC 352 - SATELLITE COMMUNICATION UNIT 1CEC 352 - SATELLITE COMMUNICATION UNIT 1
CEC 352 - SATELLITE COMMUNICATION UNIT 1

22CYT12-Unit-V-E Waste and its Management.ppt
22CYT12-Unit-V-E Waste and its Management.ppt22CYT12-Unit-V-E Waste and its Management.ppt
22CYT12-Unit-V-E Waste and its Management.ppt

Properties Railway Sleepers and Test.pptx
Properties Railway Sleepers and Test.pptxProperties Railway Sleepers and Test.pptx
Properties Railway Sleepers and Test.pptx

Engineering Standards Wiring methods.pdf
Engineering Standards Wiring methods.pdfEngineering Standards Wiring methods.pdf
Engineering Standards Wiring methods.pdf

2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf
2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf
2008 BUILDING CONSTRUCTION Illustrated - Ching Chapter 08 Doors and Windows.pdf

一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理
一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理
一比一原版(osu毕业证书)美国俄勒冈州立大学毕业证如何办理

Embedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoringEmbedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoring

一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理
一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理
一比一原版(CalArts毕业证)加利福尼亚艺术学院毕业证如何办理

Internship file for summer training

  • 1. INTERNSHIP REPORT ON MULTISTOREY RESIDENTIAL BUILDING CONSTRUCTION (29-08-2023 TO 12-09-2023) TAKEN AT NAGPUR INTEGRATED TOWNSHIP PVT. LTD. PLOT NO. 2, SECTOR-21, MIHAN, DE-NOTIFIED SEZ, KHAPRI(RLY), NAGPUR RURAL 441108,(M.H.) SUBMITTED TO:- SUBMITTED BY:- Prof. RAJESH CHAUHAN SIR PRANJAL SINGH PARIHAR HEAD OF DEPARTMENT B.E. VIITH SEMESTER CIVIL ENGINEERING CIVIL ENGINEERING ROLL NO.:- 20302013 ENROLLMENT NO.:- V20R538290001 SCHOOL OF ENGINEERING & TECHNOLOGY VIKRAM UNIVERSITY UJJAIN (M.P.) 456010 SESSION:- (2023-2024)
  • 2.
  • 3. SCHOOL OF ENGINEERING & TECHNOLOGY VIKRAM UNIVERSITY UJJAIN (M.P.) SESSION:- (2023-2024) CERTIFICATE This is to certify that the report of internship entitled “ MULTISTOREY RESIDENTIAL BUILDING CONSTRUCTION” submitted to Head of department, Civil Engineering, School of Engineering & Technology, Vikram University, Ujjain (M.P.) by Pranjal Singh Parihar, B.E. VIIth Sem, Civil Engineering, required for the fulfilment of practical and viva voice of internship. INTERNAL EXAMINER EXTERNAL EXAMINER
  • 4. ACKNOWLEDGEMENT I take this opportunity to extend my gratitude to IJM INDIA INFRASTRUCTURE PVT. LTD. as well as TEAM UNIVERSAL INFRATECH PVT. LTD for providing me an unbelievable practical learning experience during the internship. It was indeed to be a pleasure to be part of such organization for 15 days. First and foremost, I would like to thank Mr. VIDYA SAGAR INJETI, Project Manager, NITPL( for IJM INFRASTRUCTURE) and special thanks to Mr. MAHESH DESAI, Project Manager (for TEAM UNIVERSAL) and Mr. TEJRAM GOSWAMI, Engineer – Projects, and all others site engineer and lab engineer, who supported and helped me throughout the internship and for giving me nice industrial experience. Secondly, I am no less grateful to other employees and members of the department for their kind co-operation and spontaneous response. Last but not the least, I express my gratitude towards my college faculty Prof. Rajesh Chauhan Sir (HOD), Prof. Sachin Sironiya Sir, Prof. Chetan Gurjar Sir, Prof. Mohit Prajapati Sir as their guidance is never forgettable and for sharing their knowledge, helping me and gave me inspiration to complete the internship program successfully. PRANJAL SINGH PARIHAR B.E. VIITH SEM CIVIL ENGINEERING
  • 5. ABSTRACT The internship program is designed to provide students engaged in a field experience within opportunity to share their insight, to explore the links between students’ academic preparation and their field work, and to assist participants in developing and carrying out the major research project which will serve culminate their internship experience. An internship is a period of work experience offered by an organization for a limited period of time. Once confined to medical graduates, the term is now used for wide range of placements in business, non-profit organization and government agencies. They are undertaken by students and graduates looking to gain relevant skills and experience in a particular field. Employers benefit from these placements because they often recruit employees from their interns, who have known capabilities, thus saving time and money in the long run. Typically, an internship consists of an exchange of service for experience between the intern and the organization. Internship are used to determine if the interns still have an interest in that field after the real-life experience. In addition, an internship can be used to create a professional network that can assist with letters of recommendation or lead to future employment opportunities. The benefit of brining an intern into full-time employment is that they are already with the company, their position, and they typically need to no training.
  • 6. COMPANY PROFILE IJM INDIA INFRASTRUCTURE PVT. LTD IJM (India) Infrastructure Limited (IJMII) is a subsidiary company of IJM Corporation Berhad, with its Group Headquarters at Kuala Lumpur, Malaysia. It is one of the world's leading companies in infrastructure, construction, property, plantation and industry for the last 38 years of operations. IJMII, incorporated in 1998, is a pioneer in highway infrastructure, commercial and residential construction with its India operations headquartered at Hyderabad. IJMII has been delivering one sterling performance after another in its operations in India and has many firsts to its credit. IJMII has Extensive experience in Highways & Bridges and Properities: • Built over 5500 lane Km(1500+ Route Kms) of highways and 20Km of urban rail projects. • 20.2 Million Sq.ft of Prime Residential/Commercial developemnt. IJMII has been actively participating in the high growth opportunities offered by Indian Infrastructure Industry, more specifically in the construction sector. IJMII's main thrust is in construction and upgrading of highways and property development including world class townships and commercial buildings using modern technology and equipment. IJMII completed India's first flagship Expressway Project - The Mumbai Pune Expressway from Kon to Chowk in April 2000. One of the more recent projects
  • 7. completed by IJMII in 2020 is the Dewas Bypass Road Project (Madhya Pradesh). IJMII has also delivered world-class integrated townships including Rain tree Park (Malaysian Township) Kukatpally,Hyderabad, Raintree Park Dwaraka Krishna Township Phase 1, in Mangalagiri, Guntur. First City Residential Township Project, Nagpur is currently underway. The Group Company IJM Corporation Berhad, whose core competency is construction, is one of Malaysia's largest and most diversified construction groups, with world-wide presence with specialization in the areas of construction, property development, manufacturing, quarrying, plantation and international ventures. Its current operations are spread over Malaysia, India, Australia, Argentina, Chile, China, Myanmar, Singapore and Vietnam. IJM is a highly quality conscious company with the motto of "Excellence Through Quality". TEAM UNIVERSAL INFRATECH PVT. LTD (An IJM Group Company)
  • 8. Team group emerged in the year 2007 to provide services to construction & infrastructure industry. We are a team of Exceptional Engineers and Managers, who believe in constantly pushing limits and delighting our clients with our exceptional delivery capabilities and state of the art technology. Since inception we are involved in building Commercial, Residential complex, Housing, Roads, Railways, Airports. We don´t consider construction as just a business, but we provide professional Service with Passion. Today, the Team Group keep exploring new horizons in infrastructure development, housing, townships, real estate development & turnkey construction services. The professional individuals has grouped under flagship of Team Universal having registered office at Hyderabad, India, consists team of multicultural, multifaceted & versatile committed individuals & advisors who share core values & are highly focused on leveraging their complementary skills for the benefit of clients. The Team is capable of handling multiple projects, uniquely complex, with passion to excel. We are on the way to achieve our bold vision of being among top service providers in construction industry within next three-five years. Quality has been our prime objective all through and it will remain as we believe in long term relation with our clients. Efficient project management professionals & Enterprise Resource Planning tools in the right hands help us to keep up the pace while we optimize the utilization of resources and maintain transparency. The reason that makes us feel proud and stand out is our ethics and we think plan in unison and therefore deliver product with quality. We believe in importance of maintaining reputation build over past years reinforcing our motto at Team Service with Passion.
  • 9. PROJECT INFORMATION FCP Harmony, Nagpur Configuration: 2BHK, 2.5BHK, 3BHK, 3.5BHK Area: 3.9 Lakhs Sq. ft Number of Units: 210 Apartments No of Buildings: 2 Buildings (Ground+Podium+15 Floors) Location: MIHAN, Nagpur Commencement: 2023 Possession: 2027 RERA No.: P50500049468 ABOUT PROJECT:- FCP Harmony is a unique luxury apartment community in a part of 7.5 acres of prime land with stunningly designed 210 Apartments. After successfully completing the Phase-1 of the Project i.e., Symphony Buildings, the Harmony buildings are launched to cater to the market demand. The towers are equipped with 2 level car Parking with 15 residential floors - What can be more magnificent & splendid than residing in a green paradise with amenities par excellence! Enjoy the landscape from the sky-high balconies demonstrating visual richness and discover yourself falling in love with the natural change of beauty that comes with every season.
  • 10. The Harmony towers are designed with ample natural ventilation with open area on 3 sides and all along with central space dedicated to more features like clubhouse, Leisure Park (Miyawaki Forest), Party Lawn with deck, Box Cricket Pitch etc. All blocks are aligned to true north and designed as per Vastu. At present, 2 buildings i.e Harmony 1 & 6 are under construction and will be ready for possession by 2027.
  • 11. REVIEW OF TASKS PERFORMED The Internship work has been carried out at NITPL after the completion of 6th semester for the duration of 15 days. The following table shows the day wise Internship Training sessions. DATE COVERED TOPICS Day 1 29-08-2023 Overall site visit and gathered information about the project. Day 2 30-08-2023 Introduction about the components of Mivan Formwork Day 3 31-08-2023 Over view of construction plans of the project Day 4 01-09-2023 Setting up the wall reinforcement steel Day 5 02-09-2023 Inspection of the wall reinforcement steel Day 6 03-09-2023 Setting up the slab reinforcement steel and inspection on electrical and plumbing connection Day 7 04-09-2023 Placement of aluminium formwork Day 8 05-09-2023 Inspection of the placed aluminium formwork and checking the dimensions Day 9 06-09-2023 Visited near to Batching plant and materials feed in batching plant Day 10 07-09-2023 Operation of batching plant Day 11 08-09-2023 Different tests performed in lab Day 12 09-09-2023 Construction of domestic water supply tank Day 13 10-09-2023 Casting of stair case and steel binding and casting of raft foundation
  • 12. Day 14 11-09-2023 Learnt about the curing process Day 15 12-09-2023 Marking to place the bars by using total station SITE PLAN & FLOOR PLAN
  • 13.
  • 14. MIVAN TECHNOLOGY Mivan shuttering is a fast-paced construction technique which offers strength and durability to a building by use of aluminium formworks. ASSEMBLE THE MASSIVE SHAPE Because of the effortlessness of the aluminum formwork and the tedious idea of the get together cycle, it is feasible to configuration building scenes precisely and, thusly, a whole lot sooner handling time. Besides, it permits gifted specialists to help out molds, diminishing the weight on them when there is a lack of capable laborers. All boards are obviously distinguished and amassed utilizing standard formwork drawings prior to leaving the item office for simple recognizable proof nearby. Mivan accentuates the utilization of cutting-edge development advances and gear in the entirety of its activities. Subsequent to leaving the MIVAN fabricating office, all boards are plainly set apart with their space to guarantee that distinctions on the site are light and can be amassed utilizing pass on adjusting drawings. MIVAN FORMWORK ASSEMBLY
  • 15. WORK CYCLE Mivan is a method of scheduling and maintaining work cycles produced by other related building styles, such as steel-reinforced solid formations, in which the work cycle follows a specific assembly. After that, the sections and are placed at the stage level. This exercise takes 7 to 10 hours to complete. In 7 hours, the kickers and outdoor suite are complete. In 6 hours, the wall shutters will be built. The main reinforcements took 10 to 12 hours. Finally, the bob electrical conduit is fixed, and concrete is poured. This is a well-synchronized cycle of 7 days from 10 to 12 hours. Cementing is then left until the solids have taken quality before the next cycle begins and the molds are assembled from side to side in a quick and easy manner. All panels are clearly marked when leaving the Mivan processing facility, ensuring that they can be easily identified and installed nearby. The regimen usually follows a four-day cycle Day 1: The first task is to install the vertical reinforcement bars and part of the entire floor or floor on one side of the vertical formwork. Day 2: The second task is to create the second part of the vertical formwork as well as pouring the concrete. Day 3: Installation of floor slab reinforcement bars, walls and casting panels. Day 4: Column-shaped work boards are removed after 24 hours, kept in place for 7 days and formwork is kept for 2.5 days.
  • 16. Formwork – Components The plate, which is important for an aluminium bar welded to an aluminium sheet, is the principle part of the shape. The outcome is a lightweight board with a high extent to weight proportion, which avoids the substantial marginally under tension. Boards can be made to any measure or shape to address the issues of explicit applications. The boards are made of high-strength aluminium amalgam and have a 4mm thick facade plate and 6mm thick ribbed sponsorship to build up it. Mivan's exceptional offices in Europe and Southeast Asia produce boards. Whenever they are constructed, they go through a preliminary erection cycle to preclude any dimensional or positional issues. The most commonly used components in construction are listed below. Wall Components:- Wall Pannel Make a divider face. It is a sheet of aluminium that is appropriately managed to fit the specific size of the divider. WALL PANNEL
  • 17. Rocker It is a supporting component to the divider. It is a L-molded plate with adjustable openings for the heel screw. ROCKER Kicker It frames the divider face at the highest point of the boards and goes about as an edge to help. KICKER Stub Pin It helps in joining two divider boards. It helps in joining two joints.
  • 18. STUB & PINS Beam Components:- Beam Side Panel Shaped on the shafts. It has a rectangular construction and is sliced to the size of a shaft. BEAM SIDE PANNEL Prop Heads for Soffit Beam It frames an extraordinary pillar and has an Angular head that permits the molds to be effectively dismantled.
  • 19. PROP HEADS FOR SOFFIT BEAM Beam Soffit Panel It upholds the soffit shaft. It is a plain rectangular construction of aluminium. BEAM SOFFIT PANNEL Beam Soffit Bulkhead It is the bulkhead for shaft. It conveys the majority of the mass burden.
  • 20. BEAM SOFFIT BULKHEAD Deck Components:- Deck Board This structures a flat surface for the chunk shape. Intended for appropriate labour security. DECK BOARD
  • 21. Deck Prop Structures an Angular swagger head that upholds the deck and conveys the heap on the deck plate. DECK PROP Prop Length It is the length of the prop. It relies on the length of the section. PROP LENGTH Deck mid – Beam It upholds the center bit of the shaft. It holds the substantial.
  • 22. DECK MID-BEAM Other Components:- Internal Soffit Corner Structures an upward interior point between dividers, supports, pieces and equalinear moldings between dividers, brace boards and shaft support. INTERNAL SOFFIT CORNER
  • 23. External Soffit Corner Outside points structure the upward outside point between the dividers and/or shaft faces and the level outside corners between the divider/pillar face and the outside of the boards. EXTERNAL SOFFIT CORNER External Corner The outside corner interfaces ver cal or flat structure cooperate at right points. EXTERNAL CORNER
  • 24. Internal Corner It interfaces two bits of vertical formwork pieces at their inside convergences. INTERNAL CORNER
  • 25.
  • 26. DIFFERENT COMPONENTS OF MIVAN FORMWORK IN SITE
  • 27. Installation of Building Blocks With the help of sophisticated design tools, molds are created with the lowest cost selection of sheet sizes. By ensuring the most efficient assembly methods, the cheapest panel option and ultimately the reduction of capital and maintenance costs, the software, along with the knowledge and efficiency of the designers, ensures an efficient building process. ERECTION OF PLATFORM
  • 29. INSTALLING AND REMOVING DIFFERENT COMPONENTS OF MIVAN FORMWORK IN CONSTRUCTION SITE
  • 30. Mivan Construction Technique Setting up the wall reinforcing steel Placement of aluminium formwork Pouring concrete Setting up the wall reinforcing steel:- The wall reinforcing steel is used to give a structure to the building and support the concrete until they gain half of the required strength. The aluminium formworks are cast around the steel mesh, which is factory made and directly erected on the construction site.
  • 31.
  • 32. SHEAR WALL AND MIVAN WALL IN CONSTRUCTION SITE Reinforcement  Steel is the major part of construction; reinforcement provides tensile strength for the concrete. Although steel is manufactured somewhere else but like batching plant to make concrete there is a steel yard also to cut the steel into the specified shapes. For proper administrating the construction and fast progress of the work “Bar Bending Schedule” generally called BBS. Every steel rod has a number which is clearly mentioned in the RC drawings. BBS is made for each drawing and shall be handed over to the sub-contractors to cut the steel according to it. There will be monthly quality check of the steel 1 sample is taken and sent for third party testing.  BBS contains all the parts of the steel for the respective structural member. It has different structural members and the all types of steel rods with respective shapes. Those steel rods are after been cut and bent into the respective shapes are labelled with respective number so that it will be easy for the workmen to pick them up for a member and tie it up fast without an extra cross checking.
  • 33.  Lap-length is the length that one bar should be tied to another in case of extending it and it varies with the grade of concrete. The development length for M40 it should be greater than equal to 36xdiameter, M30 it should be greater than equal to 46xdiameter and for M25 it should be greater than equal to 49xdiameter.  As there are grades in concrete there are different types of steels the one used here is Fe500 which means 500 is the minimum yield stress in N/mm2 of the steel and it is mentioned in general notes that everywhere fy(Y) refers to Fe500. In our site HYSD bars are used. The works such as bending the bars and making stirrups are handed over to sub-contractors. The sub-contractors are given Bar Bending Schedule and seeing that they will cut bend and label the steel into the respective dimensions. There is a separate machine for stirrups because one will be needing many stirrups in a construction site. Placement of aluminium formwork:- Along the wall reinforcing steel, prefabricated room sized walls and floor slabs are erected. These aluminium alloy slabs are accurately made and are easy to handle. Spaces for windows, ducts, doors and other features such as staircases, pannels and sunshade(chajjas) are also integrated in these structures. The forms are joint together using the pin and wedge system, which can be dismantled quickly after the concrete structure is made. The sequence of orders and method of removal of formwork are as follows:
  • 34.  Shuttering forming the vertical faces of walls, beams and column sides should be removed in the above order first, as they bear no load but only retain the concrete.  Shuttering forming soffit of slabs should be removed next.  Shuttering forming soffit of beams, girders or other heavily loaded shuttering should be removed in the end. METHOD FOR FORM WORK:-  Formwork Drawings Site will be provided with a set of formwork drawings which entailed the followings: - Shell Plan Layout, Formwork layout drawings, Elevations and sections drawings indicating the location of formwork panels and component,
  • 35. Typical Fixing Detail drawings and location of Box outs and Transfer Box out drawings for transfer of Formwork, etc.  Pre-Check  Check if the shutters are properly cleaned by removing the concrete/ mortar and protruding nails.  Formwork shall be made to the exact dimensions within the permissible tolerances as mentioned below.  Required thickness and quality of steel conforming to IS 6461 shall be used to meet the requirements of design and surface finish.  For beam bottom & sides, proper size of steel at required spacing shall be provided to take the design loads/ pressure considering sleeves, conduit anchors & inserts. PRE CHECKING OF ALUMINIUM FORMWORK
  • 36.  Erection of formwork  Sufficiently rigid and tight to prevent the loss of grout or mortar from the concrete.  Capable of providing concrete of the correct shape and surface finish within the specified tolerance limits.  Soffits forms capable of imparting a camber if required.  The formwork may be of timber, plywood, steel, plastic or concrete depending upon the type of finish specified.  Erect staging/shuttering as per drawing/sketches in such a way that de-shuttering can be done easily including provision for re- propping, if planned.  Check the location, line, level, plumb and dimensions of the formwork to ensure that the deviations are within the permissible limits.  Provide bracing at proper places & intervals as specified by the manufacturer or as per formwork scheme to take care of lateral loads.  Apply mould oil/other coatings as release agents before reinforcement steel is placed.
  • 37.  Wire ties passing through beams, columns and walls shall not be allowed. In their place bolts passing through sleeves shall be used. For liquid retaining structures, sleeves shall not be provided for through bolts.  Check all the shutters are properly aligned and fixed firmly with required lateral supports and ties.  Check all the spanning members have proper bearing at the supports.  Forms shall be thoroughly cleaned of all dirt, mortar and other matters such as metals, blocks, saw dust and foreign materials before concreting if required through clean-out openings.  Check all the gaps/openings are properly closed to avoid leakages.  Check all the inserts and openings are exactly placed as per the drawings.  In case of leakages, bulging and sagging immediate actions shall be taken by tightening wedges or adjusting by jacks which must be done before the concrete takes its initial set.  Wedges or jacks shall be secured in position after the final check of alignment.  Removal of Forms  Formwork components shall not be dropped but shall be lowered without damage to the components and structures. All the removed
  • 38. formwork materials shall be thoroughly scarped, cleaned immediately and stacked properly for reuse.  All forms shall be removed after the minimum period stipulated mentioned below without damage to the concrete including removal without shock as per IS 456. CONSTRUCTION SITE PHOTOS
  • 39. Batching Plant A Concrete Batching Plant is a machine to manufacture Concrete from its ingredients viz Cement, Crushed Stone, Sand, Water and Admixture Chemicals. The word Batching Plant comes from the word "Batch", which essentially means that concrete is manufactured in measured bathes inside a Concrete Batching Plant. Material feeding:-  Cement OPC 53 Grade  Fly Ash  Aggregate 10mm  Aggregate 20mm  Crushed Stone Dust  Sand  Water  Poly Vinyl Plasticizers Grade Of Concrete Used In Construction:-  M20 for PCC work  M30 for Slab Casting  M40 for Shear Wall and Foundation. Concrete Strength Test Result:- Grade Of Concrete 7 Days 14 Days 28 Days M20 22.15 N/mm2 27.83 N/mm2 34.59 N/mm2 M30 34.63 N/mm2 42.34 N/mm2 60.13 N/mm2 M40 42.29 N/mm2 48.22 N/mm2 55.72 N/mm2
  • 40.
  • 41. Pouring Concrete:- After casting the forms, high-quality concrete is poured. This concrete takes the form and shape of the cast, which is later removed to make way for a structure made entirely of cement concrete supported by wall reinforcing steel. The aluminium forms can be reused at least 250 times, resulting in minimum waste from the construction site Ensure site coordinators are available and on stand-by during the concreting process. Always ensure that concrete pouring is distributed evenly throughout the wall sections before commencing to cast the slab level areas. This is to prevent loading pressure on the formwork panels due to uneven casting. Recheck the areas whenever cement slurry leakage is noted to determine the cause of it. Remedy work should be done immediately to ensure the concreting process is not affected. During concreting, always ensure that immediate step is taken to remove/clean all the excess concrete that is stuck on the back of the formwork panels. Non removal will result in the formwork panels getting too heavy and also the scrapping task after the concrete has dried up becomes more tedious.
  • 42.
  • 43. CURING Curing of concrete is defined as providing adequate moisture, temperature, and me to allow the concrete to achieve the desired proper es for its intended use. Curing is essen al for the hydra on of cement in concrete making. So, to maintain required moisture content. From the next day of concre ng the curing has to be done con nuously for the next 7 days. The curing has been done by the spraying method for aluminium formwork structures. For conven onal structure, membrane curing has been done.
  • 44. Advantages of Mivan Technology  The time frame for the construction is drastically reduced and is more advantages and sustainable for fast track project.  As the walls are casted along with slab as monolithic, the time for construction of walls and plaster is reduced.  Wall thickness is reduced and hence the dead load is reduced and economically the structure and foundation can be designed.  These structures result unnatural high strength against natural disastrous due to its unique style monolithic structure as compared to the conventional.  Number of activities can be reduced.  The form (Mivan Shuttering) is a self-aligning and locking system which ensures dimensional accuracy with less manpower. Disadvantages of Mivan Technology  Its initial cost and setup time is higher than conventional formwork.  Less Scope of modification or alteration.  Visible finishing lines.  Expensive in construction.  Can have contraction cracks.
  • 45. FOUNDATION Foundation is one of the essential parts of the structure. It is defined as that part of the structure that transfers the load from the structure constructed on it as well as its weight over a large area of soil in such a way that the amount does not exceed the ultimate bearing capacity of the soil and the settlement of the whole structure remains within a tolerable limit. Foundation is the part of a structure on which the building stands. The solid ground on which it rests is known as the foundation bed. Raft or Mat Foundation:- Raft or Mat foundations are used where other shallow or pile foundations are not suitable. It is also recommended in situations where the bearing capacity of the soil is inadequate, the load of the structure is to be distributed over a large area, or the structure is subjected continuously to shocks or jerks. A raft foundation consists of a reinforced concrete slab or T-beam slab placed over the entire area of the structure. In this type, the whole basement floor slab acts as the foundation. The total load of the structure is spread evenly over the entire area of the structure. This is called a raft because, in this case, the building seems like a vessel that floats on a sea of soil. Raft foundations are economic when:-  The soil is weak and the load has to be spread over a large area.  The structure includes a basement.  Columns are closely placed.  Other kinds of foundations are not feasible.  Differential settlement is to be prevented.
  • 47. TOTAL STATION A total station is an electronic/optical instrument used in modern surveying and building construction that uses electronic transit theodolite in conjunction with electronic distance meter (EDM). It is also integrated with microprocessor, electronic data collector and storage system The instrument is used to measure sloping distance of object to the instrument, horizontal angles and vertical angles. This Microprocessor unit enables for computation of data collected to further calculate the horizontal distance, coordinates of a point and reduced level of point. Data collected from total station can be downloaded into computer/laptops for further processing of information. DISTANCE MEASUREMENT:- 1. Setting of the Atmospheric Correction When setting the atmospheric correction, obtain the correct value by measuring the temperature and pressure. 2. Setting of the Correction for Prism Constant Topcon’s prism constant value is 0. Set correction for prism at 0. If the prism is of another manufacture, the appropriate constant shall be set beforehand. 3. Distance Measurement (Continuous Measurement) Make sure the mode displays angle measurement.
  • 48.
  • 49. Benefits of this Internship  Practical skills are improved.  Communication skills are developed.  Learnt different types of Construction works and its uses.  Learnt to execute the work as planned. More Construction Site Images
  • 50.
  • 51.
  • 52. CONCLUSION It has been a remarkable experience in working with IJM INFRASTRUCTURE & TEAM UNIVERSAL INFRATECH PVT. LTD. in the project “NAGPUR INTEGRATED TOWNSHIP PVT. LTD. (First City Harmony Buildings 1-6)”, where I could witness all the phases of construction for 15 days in Nagpur. I have been exposed to all the phases of the site where I have learned many useful things to develop my intuition and gained knowledge about almost all of the aspects. I have witnessed different challenges in such a short time period. The caring accommodation in the office shows the true experience and kindness of every employee here. I am very thankful to all of the employees here for guiding me through a wonderful life experience with a positive composure. I am sure that this experience would guide me in life and drive me towards my goals. ---------------x---------------
