11MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
MARCH 2017 (As on 31 March 2017)
22MARCH 2017
❖ Executive Summary ..................................3
❖ Advantage State ........................................4
❖ State Vision 2018 ......................................5
❖ Haryana – An Introduction …....................6

❖ Budget 2016-17 ......................................17
❖ Infrastructure Status ................................18
❖ Business Opportunities ...........................42
❖ Doing Business in Haryana ....................63
❖ State Acts & Policies ...............................64
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
MARCH 2017
33MARCH 2017 For updated information, please visit www.ibef.org

EXECUTIVE SUMMARY
HARYANA THE BREAD BASKET OF INDIA
Strong economic growth
• With an area covering 1.3% of the country, Haryana contributes nearly 3.63% to India’s
GSDP. During 2005-16, the state’s GSDP grew at a CAGR of 11.79%.
Leading manufacturing
hub
• Haryana is home to Maruti Udyog Ltd, India’s largest passenger car manufacturer & Hero
MotoCorp Ltd, the world's largest manufacturer of 2-wheelers. Under Make in India
project, Manesar-Bawal Investment Region has been identified by the Government to be a
manufacturing hub.
Leading food producer
• Haryana is the 2nd-largest contributor of food grains to India’s central pool.
• The state accounts for more than 60% of the export of Basmati rice in the country.
Growing IT sector
• Haryana is the third-largest exporter of software and one of the preferred destinations for
IT/ITeS facilities.
Infrastructure support
• The state invested in the development of world class infrastructure facilities such as
special economic zones (SEZs), Kundli-Manesar-Palwal (KMP) global corridor and Delhi-
Mumbai Industrial Corridor (DMIC).
• Haryana enjoys a locational advantage, with nearly one-third of the state’s area under the
National Capital Region (NCR), a prominent trade and consumption centre.
• The state has almost 100% connectivity to rural areas, with metalled roads.
Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office, Economic Survey of Haryana 2015-16
44MARCH 2017 For updated information, please visit www.ibef.org

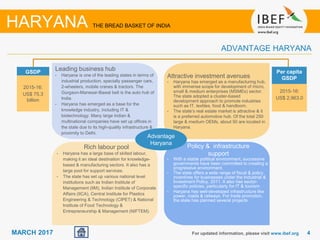

HARYANA THE BREAD BASKET OF INDIA
GSDP
2015-16:
US$ 75.3
billion
Per capita
GSDP
2015-16:
US$ 2,963.0
ADVANTAGE HARYANA
Growing demand
Advantage
Haryana
Leading business hub
• Haryana is one of the leading states in terms of
industrial production, specially passenger cars,
2-wheelers, mobile cranes & tractors. The
Gurgaon-Manesar-Bawal belt is the auto hub of
India.
• Haryana has emerged as a base for the
knowledge industry, including IT &
biotechnology. Many large Indian &
multinational companies have set up offices in
the state due to its high-quality infrastructure &
proximity to Delhi.
Attractive investment avenues
• Haryana has emerged as a manufacturing hub,
with immense scope for development of micro,
small & medium enterprises (MSMEs) sector.
The state adopted a cluster-based
development approach to promote industries
such as IT, textiles, food & handloom.
• The state’s real estate market is attractive & it
is a preferred automotive hub. Of the total 250
large & medium OEMs, about 50 are located in
Haryana.
Policy & infrastructure
support
• With a stable political environment, successive
governments have been committed to creating a
progressive environment.
• The state offers a wide range of fiscal & policy
incentives for businesses under the Industrial &
Investment Policy, 2011. It also has sector-
specific policies, particularly for IT & tourism.
• Haryana has well-developed infrastructure like
power, roads & railways. For trade promotion,
the state has planned several projects.
Rich labour pool
• Haryana has a large base of skilled labour,
making it an ideal destination for knowledge-
based & manufacturing sectors. It also has a
large pool for support services.
• The state has set up various national level
institutions such as Indian Institute of
Management (IIM), Indian Institute of Corporate
Affairs (IICA), Central Institute for Plastics
Engineering & Technology (CIPET) & National
Institute of Food Technology &
Entrepreneurship & Management (NIFTEM).
5MARCH 2017
Infrastructure
Housing
Tourism
Economy
Irrigation
Agriculture
Welfare Education
• Contain revenue & fiscal deficit.
• Commencement of mining & e-
taxation projects would reduce
revenue deficit.
• Ensure availability of affordable
housing for all.
• Provide financial assistance for
construction.
• Offer loans at reasonable terms to
BPL families.
• Improve quality of education and
access to schools.
• Expand college and university
network.
• Enhance sports education and
infrastructure to prepare people
for competing at international &
national events.
• Fully utilise nature’s endowment.
• Create network of business and
tourism facilities.
• Schemes to develop SC, BC and
other vulnerable sections of society.
• Healthcare for women and children.
• Modernise police department.
• Manage surface water resources
efficiently.
• Improve water availability by
pursuing upstream storage dams.
• Implement schemes for
remodelling, rehabilitate water
courses, flood control.
• Timely availability of quality
feedstock at subsidised rates.
• Modernise irrigation systems.
• Pursue crop diversification &
introduce modern technologies.
• Develop IMTs, industrial
parks & expand industrial estates
• Create E-biz portal to ensure ease of
doing business.
• Address needs of MSMEs in areas of
R&D and technology; develop rail
connectivity to airports, etc.
HARYANA THE BREAD BASKET OF INDIA
STATE VISION 2018
Vision
2018
For updated information, please visit www.ibef.org
Source: Government of Haryana
66MARCH 2017 For updated information, please visit www.ibef.org
HARYANA FACT FILE
Haryana is surrounded by Uttar Pradesh in the east, Punjab
in the west, Himachal Pradesh in the north & Rajasthan in
the south. The state surrounds the national capital city, New
Delhi, from 3 sides.
The most commonly spoken languages are Hindi & Punjabi.
English is the medium of education in most schools.
Gurgaon, Faridabad, Karnal, Ambala, Panipat &
Kurukshetra are some of the key districts of the state.
The state has 3 major seasons, viz., summer (April-June),
monsoon (July-September) and winter (October-March).
Source: Economic Survey of Haryana 2015-16
Parameters Haryana
Capital Chandigarh
Geographical area (sq km) 44,212
Administrative districts (No) 21
Population density (persons per sq
km)
573
Total population (million) 25.4
Male population (million) 13.5
Female population (million) 11.9
Sex ratio (females per 1,000 males) 879
Literacy rate (%) 75.5
HARYANA THE BREAD BASKET OF INDIA
Source: Maps of India
77MARCH 2017
Parameter Haryana All states Source
Economy 2015-16 2015-16
Gross state domestic product (GSDP) as a
percentage of all states’ GSDP
3.63 100.0
Directorate of Economics & Statistics of
Haryana, Central Statistics Office
GSDP growth rate (%) 4.24 8.71
Directorate of Economics & Statistics of
Haryana, Central Statistics Office
Per capita GSDP (US$) 2,963.0 1,546
Directorate of Economics & Statistics of
Haryana, Central Statistics Office
Physical Infrastructure

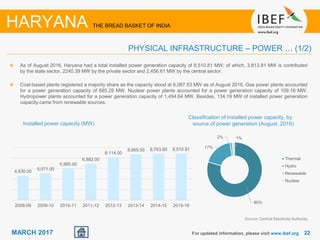

Installed power capacity (MW) 8,510.81 305,554.25
Central Electricity Authority, as of August
2016
Wireless subscribers (No) 22,967,344 1,078,422,215
Telecom Regulatory Authority of India, as of
October 2016
Internet subscribers (No) 8,300,000 367,480,000
Telecom Regulatory Authority of India, as of
September 2016
National highway length (km) 2,622.48 100,087.08 NHAI & Roads and Building Department
Airports (No) 8 125 Airports Authority of India
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA

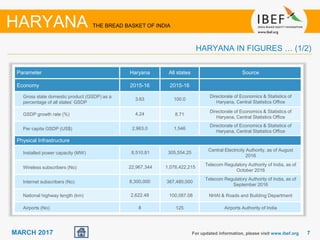

HARYANA IN FIGURES … (1/2)
88MARCH 2017
Parameter Haryana All states Source
Social Indicators
Literacy rate (%) 75.5 73.0 Census, 2011
Birth rate (per 1,000 population) 21.3 21.6 SRS Bulletin
Investment
FDI equity inflows (US$ billion) 66.991 324.35
Department of Industrial Policy & Promotion,
April 2000 to December 2016
Industrial Infrastructure
Completed and operational PPP projects
(No)
12 1,246
DEA, Ministry of Finance, Government of India,
July 2016
Operational SEZs (no) 7 186
Ministry of Commerce & Industry, Department
of Commerce, July 2016
For updated information, please visit www.ibef.org
HARYANA IN FIGURES … (2/2)
HARYANA THE BREAD BASKET OF INDIA
Source: 1Includes Delhi, part of UP
PPP: Public-Private Partnership, SRS: Sample Registration System
99MARCH 2017
24.7
28.5
37.6 39.6
47.2
57.1
64.4 63.6 65.2
72.2
75.3

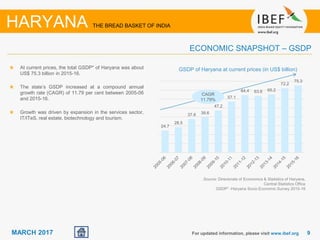

At current prices, the total GSDP* of Haryana was about
US$ 75.3 billion in 2015-16.
The state’s GSDP increased at a compound annual
growth rate (CAGR) of 11.79 per cent between 2005-06
and 2015-16.
Growth was driven by expansion in the services sector,
IT/ITeS, real estate, biotechnology and tourism.
GSDP of Haryana at current prices (in US$ billion)
CAGR
11.79%
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – GSDP
HARYANA THE BREAD BASKET OF INDIA
Source: Directorate of Economics & Statistics of Haryana,
Central Statistics Office
GSDP* -Haryana Socio Economic Survey 2015-16

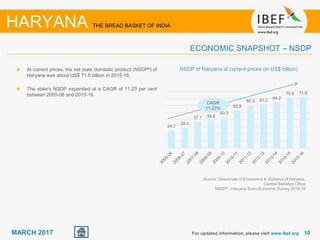

1010MARCH 2017
24.7
28.4
37.1 38.8
43.3
52.9
60.3 61.2
64.2
70.8 71.6
At current prices, the net state domestic product (NSDP#) of
Haryana was about US$ 71.6 billion in 2015-16.
The state’s NSDP expanded at a CAGR of 11.23 per cent
between 2005-06 and 2015-16.
NSDP of Haryana at current prices (in US$ billion)
CAGR
11.23%
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – NSDP
HARYANA THE BREAD BASKET OF INDIA
Source: Directorate of Economics & Statistics of Haryana,
Central Statistics Office
NSDP# - Haryana Socio Economic Survey 2015-16
1111MARCH 2017
1,210
1,569
1,620 1,898
2,261
2,508
2,436 2,459 2,723
2,963

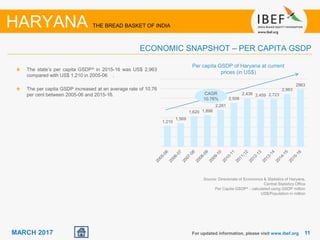

2963
The state’s per capita GSDP^ in 2015-16 was US$ 2,963
compared with US$ 1,210 in 2005-06 .
The per capita GSDP increased at an average rate of 10.76
per cent between 2005-06 and 2015-16.
Per capita GSDP of Haryana at current
prices (in US$)
CAGR
10.76%
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – PER CAPITA GSDP
HARYANA THE BREAD BASKET OF INDIA
Source: Directorate of Economics & Statistics of Haryana,
Central Statistics Office
Per Capita GSDP^ - calculated using GSDP million
US$/Population in million
1212MARCH 2017

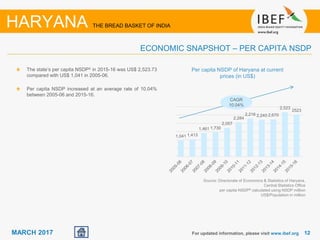

1,041 1,413
1,461 1,730
2,057
2,284
2,216 2,240 2,670
2,523
2523
The state’s per capita NSDP& in 2015-16 was US$ 2,523.73
compared with US$ 1,041 in 2005-06.
Per capita NSDP increased at an average rate of 10.04%
between 2005-06 and 2015-16.
Per capita NSDP of Haryana at current
prices (in US$)
CAGR
10.04%
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – PER CAPITA NSDP
HARYANA THE BREAD BASKET OF INDIA
Source: Directorate of Economics & Statistics of Haryana,
Central Statistics Office
per capita NSDP& calculated using NSDP million
US$/Population in million
1313MARCH 2017
23.30% 18.20%
32.70%
30.60%
44.00%
51.20%
2004-05 2015-16
Primary Secondary Tertiary
Tertiary sectorµ is the largest contributor to Haryana’s
economy. In 2015-16, it contributed 51.2% to the state’s
GSDP at current prices. It was followed by the secondary
sector at 30.6 per cent.
The tertiary sector grew at an average rate of 13.68 per cent
between 2004-05 and 2015-16. The growth was led by
trade, hotels, real estate, finance, insurance, transport and
communications.
The secondary sectorµ grew at an average rate of 11.45%
between 2004-05 and 2015-16. Its growth was driven by
manufacturing, construction, and electricity and gas & water
supply.
The primary sectorµ grew at an average rate of 9.63%
between 2004-05 and 2015-16.
GSDP composition by sector
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – PERCENTAGE DISTRIBUTION OF GSDP
HARYANA THE BREAD BASKET OF INDIA
CAGR
9.63%
13.68%
11.45%
Source: Directorate of Economics & Statistics of Haryana,
Central Statistics Office
Sector-wise %share of GSDPµ -Haryana Socio Economic
Survey 2015-16
1414MARCH 2017
Source: Economic Survey of Haryana, 2015-16, Ministry of Agriculture-
Department of Agriculture & Cooperation, Government of India,
State Budget 2016-17
Wheat, sugarcane, rice, cotton, rapeseed and mustard
are key agricultural products of the state.
Total food grain production in Haryana stood at 17.34
million tonnes in 2015-16.
In 2015-16, the average yield of wheat and rice in
Haryana was 4,700 and 3,450 kg per hectare,
respectively.
For the enhancement and improvement of the agriculture
sector, the state government has allocated a total
amount of US$ 2.06 billion during 2016-17.
As per the budget 2016-17, a new farm insurance
scheme has been launched by the state government,
namely, “Pradhanmantri Fasal Bima Yojana”, with an
allocation of US$ 45.82 million to minimise damages in
the farm sector.
Further, the state government has also proposed to
increase the grant-in-aid to the agriculture university of
Haryana by 9.22% i.e. from US$ 51.47 million in 2015-16
to US$ 56.21 million in 2016-17.
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – AGRICULTURAL PRODUCTION
HARYANA THE BREAD BASKET OF INDIA
Crop Area (‘000 Ha)
Annual production –
2015-16 (‘000 MT)
Rice 1,200.00 4,140.00
Wheat 2,520.00 11,844.00
Oilseeds 625 1,146.00
Total pulses 61.00 63.00
Total food
grains
4,528.00 17,344.00
Onion 16.00 399.85
Potato 33.70 239.34
Tomato 17.69 340.84
Sugarcane 120.00 9,120
Fruits 53.09 384.06
Vegetables 312.81 3,547.17
1515MARCH 2017
According to the Department of Industrial Policy &
Promotion (DIPP), cumulative foreign direct
investment (FDI) inflows from April 2000 to
December 2016 were recorded at US$ 66.99
billion.
The services sector accounted for a major share in
FDI followed by real estate & electricity.
During 2015-16, various projects, such as,
enhancement in operational efficiency, addition in
capacity generation, extension of distribution
network, etc. were taken up by the state
government for fulfilling the need of power
availability maximization in the state. However,
during 2016-17, the state government has taken the
decision to adopt the scheme of Ujwal Discom
Assurance Yojna (UDAY), which is expected to
increase the financial as well as operational
capacity of Power Corporations of the state.
As per the announcements made by the Haryana
government, the state received investment offers
worth US$ 259.7 million from leading companies in
the fields of electronics, solar energy & beverages.
In 2017, the government allocated substantial
investment for digitization and development of
power sectors of Gurugram, in lieu of the steadfast
growth of the state and the role of Gurugram
towards its development.
Source: Department Of Industrial Policy & Promotion,
1Includes Delhi, part of UP
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – FDI INFLOWS & INVESTMENTS
HARYANA THE BREAD BASKET OF INDIA
FDI equity inflows1, 2008-09 to 2015-16 (US$ million)
4,530 5,071
5,985
6,882
8,114
6,242 6,875
12,743
2008-09 2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16
Companies Investment Offers to Haryana Government
PLG Clean Energy Group
US$ 198.59 million for production of 250MW
solar energy
Videocon Group US$ 22.91 million in Haryana
Asahi Group, Japan
US$ 22.91 million, for setting up a beverage
plant
Essel Group US$ 15.27 million
Source: Economic Times
1616MARCH 2017
5.6
6.6
7.4 7.6
9.2
10.6 10.1
11.0
12.6 12.7

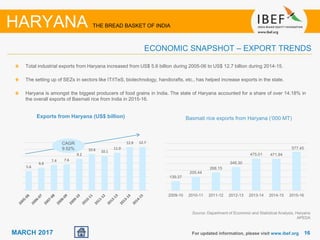

Total industrial exports from Haryana increased from US$ 5.6 billion during 2005-06 to US$ 12.7 billion during 2014-15.
The setting up of SEZs in sectors like IT/ITeS, biotechnology, handicrafts, etc., has helped increase exports in the state.
Haryana is amongst the biggest producers of food grains in India. The state of Haryana accounted for a share of over 14.18% in
the overall exports of Basmati rice from India in 2015-16.
Source: Department of Economic and Statistical Analysis, Haryana
APEDA
Exports from Haryana (US$ billion)
For updated information, please visit www.ibef.org
ECONOMIC SNAPSHOT – EXPORT TRENDS
HARYANA THE BREAD BASKET OF INDIA
CAGR
9.52%
Basmati rice exports from Haryana (‘000 MT)
139.37
205.44
268.15
349.30
475.01 471.94
577.45
2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16
17MARCH 2017
HARYANA THE BREAD BASKET OF INDIA
BUDGET 2016-17
For updated information, please visit www.ibef.org
Source: Haryana Budget 2016-17, Department of Finance, Government of Haryana
State Budget 2016-17
Sectoral allocation In US$ million
Irrigation 330.41
Power 2,570.53
Education 1,992.64
Sports 44.84
Technical education & industrial training 139.81
Health, medical education & family welfare 598.37
Public health engineering 474.85
Social welfare, nutrition & welfare of SCs & BCs 945.59
Industries & minerals 126.61
Transport 376.47
Agriculture & allied services 2,061.41
Social Justice and empowerment 643.19
Roads & buildings 685.16
Rural development 431.48
Urban development 542.17
1818MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
PHYSICAL INFRASTRUCTURE – ROADS…(1/2)
As of December 2015, Haryana has a total road network of 26,016 km out of which 2,622.48 km is constituted by the National
Highways and 1,801 km are state highways. Haryana is among the states having almost 100% connectivity to rural areas with metalled
roads. Haryana Roadways, with its fleet of nearly 4,215 buses, is one of India’s biggest state road transport undertakings which operate
across 12.70 lakh km everyday. As per budget 2016-17, the state government created a new scheme “Expenditure on Road Safety” for
enhancing the safety on roads in the state. During 2016-17, various road projects of Dadri, Narnaul, Rewari, Sonepat and Narnaul that
have a length of 395 km, are under process for posing to NCRPB for funding. The estimated cost of these projects is recorded to be
US$ 162.54 million.
The state government sanctioned a work programme for renovation of major district roads, state highways, other district roads, etc. at
an amount of US$ 238.31 million during 2015-16. Out of these projects, some are under process while the others are to be taken up
during 2016-17. Moreover, the state government has also projected to widen VT roads of 250 km from 3.66 metres to 5.50 metres.
Source: Economic Survey of Haryana, 2015-16,
Ministry of Road Transport & Highways, Government of India, News articles, NHAI
Note: 2015-16(1) : Till December 2015
National highway length completed (km)
92.74
34.48
86.00
2012-13 2013-14 2014-15
Pradhan Mantri Gram Sadak Yojana (PMGSY) was launched in 2000
with the objective of connecting eligible rural habitants. During 2015-
16 (up to October 2015), a total amount of US$ 36.20 million was
allocated to the state under PMGSY.
Pradhan Mantri Gram Sadak Yojana (PMGSY)
(2015-16-up to October, 2015)
Length completed 138.82
Expenditure on construction of national highways in Haryana
(US$ million)
14.51
8.88 10.03
12.48
2012-13 2013-14 2014-15 2015-16⁽¹⁾
1919MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
PHYSICAL INFRASTRUCTURE – ROADS…(2/2)
Source: Ministry of Road Transport & Highways, National Highway Authority of India, N.A. Not Available
Projects under implementation (as of September 2015)
Stretch Funded by Phase NH
Length
(km)
Start
date
Estimated completion
date
Supervision consultant
& nationality
• Flyover construction at
Bahalgarh ch.41.210 and
additional 2-lane bridge
construction near Rasoi
Ch.32.28 on NH-1
• Km 29.30 to Km 86.0
• NHAI
• Misc. Projects
1 56.7 Nov 2014 Nov 2016
Gawar Construction Ltd.,
Indian
• 8-lane construction from
Mukarba Chowk to Panipat
• Km.15.500 to Km.86.600
• BOT
• Misc. projects
1 69.84 N.A. N.A.
M/s Essel Infraprojects
Ltd-
Indian
• Bhatinda-Suratgarh (ROB)
• NHAI
• Misc. projects
32-B N.A. Jan 2014 Apr 2016
Gawar Construction Ltd.-
Indian
2020MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
PHYSICAL INFRASTRUCTURE – RAILWAYS
As of August 2015, Haryana had a 1,630-km long rail route. Kalka,
Kurukshetra, Rohtak, Jind, Hisar, Ambala, Panipat, Gurgaon & Jakhal
are some of the important railway stations. There is a railway workshop
at Jagadhari.
During 2015-16, the construction of Sonepat-Jind railway line was
completed at an estimated cost of US$ 113.19 million, testing of which
is under process. Moreover, the land acquisition work of Rohtak-
Meham-Hansi railway line is also under process, which is expected to
be completed at a cost of US$ 62.02 million. Consequently, the work
on shifting of the railway line of Rohtak-Panipat out of the land
acquisition by MC Rohtak is also under process. The total cost
associated with the project is recorded to be US$ 27.65 million.
The state government will provide 50% of the US$ 423.5 million funds
for implementing three railway line projects: Delhi-Sohna-Nuh-Ferozpur
Jhirka-Alwar (104 km), Hisar-Agroha-Fatehabad-Sirsa (93 km) and
Yamunanagar-Sadhora-Naraingarh-Chandigarh (91 km).
As per the state budget 2016-17, for the establishment of a rail link
between Rohtak, Hansi and Meham, the state government has
provided various funds during 2016-17.
Railway Ministry declared its plans to set up a new joint venture
between the Haryana government and Railways for upgradation of
railway stations and strengthening infrastructure in the state. Railways
has also signed a MOU with Haryana government regarding the
plantation of saplings on vacant land on both sides of railway lines.
Source: Economic Survey of Haryana, 2015-16
Source: Maps of India
Railway lines in progress (2015)
Railway line
Project cost
(US$ million)
Rohtak-Meham-Hansi 62.02
Shifting of Rohtak-Panipat
railway line out of MC Rohtak
27.65
2121MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
PHYSICAL INFRASTRUCTURE – AIRPORTS
There is a domestic airport at Chandigarh and civil aerodromes at Pinjore, Karnal, Hissar, Bhiwani and Narnaul. The state has a total of
8 airports, which includes both operational and non-operational airports.
An international cargo airport and aircraft maintenance hub is proposed in Rohtak, Haryana. The airport would be built in the PPP mode
with HSIIDC. As per the state budget 2016-17, the Chief Minister of Haryana announced to upgrade the Hisar civil aerodrome into an
international airport. Under the first phase of construction, the state government is planning to modernise and renovate the buildings of
the terminal and expand the runway from 4,000 feet to 6,000 feet, at a total cost of US$ 7.63 million during 2016-17.
Also, as per the state budget 2016-17, the civil aerodrome in Karnal is proposed to be upgraded to a domestic airport during 2016-17.
Therefore, for the development of civil aviation sector in the state, a total allocation of US$ 13.71 million has been made by the state
government during 2016-17.
In September 2015, a new terminal at Chandigarh airport was inaugurated. The terminal is capable of handling both domestic and
international flights. The cost incurred in the construction of the airport by AAI is US$ 155.77 million. A stake of 51% was taken by the
AAI and shares of 24.5% each were held by the state’s of Punjab and Haryana.
Source: Economic-Survey, 2015-16
Airports Authority of India,
Domestic
airport
Passengers (lakh) Aircraft movement (‘000) Freight (‘000 MT)
2013-14 2014-15 2015-16 2013-14 2014-15 2015-16 2013-14 2014-15 2015-16
Chandigarh 10.494 12.063 15.340 9.690 10.968 13.130 3.315 5.065 4.559
2222MARCH 2017 For updated information, please visit www.ibef.org
As of August 2016, Haryana had a total installed power generation capacity of 8,510.81 MW; of which, 3,813.81 MW is contributed
by the state sector, 2240.39 MW by the private sector and 2,456.61 MW by the central sector.
Coal-based plants registered a majority share as the capacity stood at 6,087.53 MW as of August 2016. Gas power plants accounted
for a power generation capacity of 685.29 MW. Nuclear power plants accounted for a power generation capacity of 109.16 MW.
Hydropower plants accounted for a power generation capacity of 1,494.64 MW. Besides, 134.19 MW of installed power generation
capacity came from renewable sources.
PHYSICAL INFRASTRUCTURE – POWER … (1/2)
HARYANA THE BREAD BASKET OF INDIA
Installed power capacity (MW)
Classification of installed power capacity, by
source of power generation (August, 2016)
Source: Central Electricity Authority
80%
17%
2% 1%
Thermal
Hydro
Renewable
Nuclear
4,630.00
5,071.00
5,985.00
6,882.00
8,114.00
8,665.00 8,753.60 8,510.81
2008-09 2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16
2323MARCH 2017
The total number of electricity consumers in the state
increased from 35,44,380 in 2001-02 to 55,62,019 in 2015-
16. In annual plan 2015-16, the Government of Haryana
proposed an allocation of US$ 1.09 billion for restructuring
of power sector in the state.
To produce power from bagasse cooperation in sugar mills,
6 projects of 60 MW capacity have been established in
cooperative sugar mills of the state in 2015. Furthermore, a
25 MW capacity project at Naraingarh sugar mill is under
execution.
The state government has proposed to set up around 3,050
solar water pumping systems in the state during 2016-17.
In the 2016-17 budget, the state government launched a
new scheme “Mhara Gaon Jagmag Gaon” with a view to
provide 24x7 supply of power across rural domestic
consumers as well. Further, during 2016-17, the
government decided to spread the scheme to cover around
260 feeders in the state.
Moreover, the state government allocated an amount of
US$ 2.57 billion for enhancement of power sector in the
state during 2016-17.
SPML Infra has got an order worth US$ 37.19 million, for
power distribution & transmission in the state.
Source: Haryana Power Generation Corporation Ltd; Economic Survey 2015-16;
Haryana Budget 2016-17
Proposed projects
• 1,500 MW gas-based project at Faridabad
• 660 MW capacity thermal unit at Yamuna Nagar
• 2,800 MW (4x700 MW) nuclear power plant near
Fatehabad
• Projects under implementation
• 1,320 MW Mahatma Gandhi Thermal Power
Project, at Jhajjar
• Procurement of 2,113 MW on a long term basis
through tariff based competitive bidding
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
PHYSICAL INFRASTRUCTURE – POWER … (2/2)
2424MARCH 2017

Telecom infrastructure (as of October 2016)
Wireless subscribers 22,967,344
Wireline subscribers 354,431
Internet subscribers
(1)
8,300,000
Tele density (in %) 84.08
Source: Telecom Regulatory Authority of India; Department of
Telecommunications- Ministry of Communications & Information Technology,
India Post, TechSci Research
1As of September 2016
GP-Gram Panchayat
According to the Telecom Regulatory Authority of India (TRAI),
Haryana had nearly 22.96 million wireless subscribers and 354,431
wireline subscribers as of October 2016. The number of internet
subscribers in the state as of October 2015, stood at 8.30 million.
By the end of October 2016, 9,554,272 subscribers had submitted
requests for mobile number portability in Haryana. Moreover, the
state of Haryana had a tele-density of 84.08%.
In consultation with telecom power companies, Haryana government
has rolled out a new Communication and Connectivity Policy to
provide a major push to telecom and communication infrastructure in
the state.
The Department of Telecommunications (DoT) initiated a project in
2011, the National Optical Fibre Network (NOFN), with an aim of
providing broadband services to 2,50,000 gram panchayats across
the country. By February 2015, 6,097 gram panchayats had access to
broadband services in Haryana.
For updated information, please visit www.ibef.org
PHYSICAL INFRASTRUCTURE – TELECOM
HARYANA THE BREAD BASKET OF INDIA

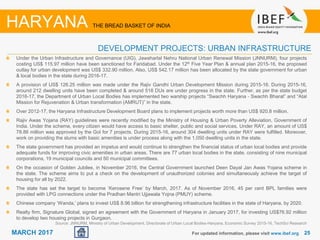

Postal facilities (2015-16, up to December 2015)
Head post offices 16
Sub post offices 481
Branch post offices 2,180
Total post offices 2,677
Performance status of NOFN (Bharat Net) project
(as of April 2016)
No. of GPs in Phase-I 6,090
Pipe laid (km) 5,304
Cables laid (km) 4,850
GPs for which cable laid 3,147
No. of Gram Panchayats Lit 160
2525MARCH 2017
Source: JNNURM, Ministry of Urban Development, Directorate of Urban Local Bodies-Haryana, Economic Survey 2015-16, TechSci Research
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
DEVELOPMENT PROJECTS: URBAN INFRASTRUCTURE
Under the Urban Infrastructure and Governance (UIG), Jawaharlal Nehru National Urban Renewal Mission (JNNURM), four projects
costing US$ 115.97 million have been sanctioned for Faridabad. Under the 12th Five Year Plan & annual plan 2015-16, the proposed
outlay for urban development was US$ 332.90 million. Also, US$ 542.17 million has been allocated by the state government for urban
& local bodies in the state during 2016-17.
A provision of US$ 126.25 million was made under the Rajiv Gandhi Urban Development Mission during 2015-16. During 2015-16,
around 212 dwelling units have been completed & around 518 DUs are under progress in the state. Further, as per the state budget
2016-17, the Department of Urban Local Bodies has implemented two warship projects “Swachh Haryana ‐ Swachh Bharat” and “Atal
Mission for Rejuvenation & Urban transformation (AMRUT)” in the state.
Over 2012-17, the Haryana Infrastructure Development Board plans to implement projects worth more than US$ 920.8 million.
Rajiv Awas Yojana (RAY) guidelines were recently modified by the Ministry of Housing & Urban Poverty Alleviation, Government of
India. Under the scheme, every citizen would have access to basic shelter, public and social services. Under RAY, an amount of US$
78.86 million was approved by the GoI for 7 projects. During 2015-16, around 304 dwelling units under RAY were fulfilled. Moreover,
work on providing the slums with basic amenities is under process along with the 1,050 dwelling units in the state.
The state government has provided an impetus and would continue to strengthen the financial status of urban local bodies and provide
adequate funds for improving civic amenities in urban areas. There are 77 urban local bodies in the state, consisting of nine municipal
corporations, 19 municipal councils and 50 municipal committees.
On the occasion of Golden Jubilee, in November 2016, the Central Government launched Deen Dayal Jan Awas Yojana scheme in
the state. The scheme aims to put a check on the development of unauthorized colonies and simultaneously achieve the target of
housing for all by 2022.
The state has set the target to become ‘Kerosene Free’ by March, 2017. As of November 2016, 45 per cent BPL families were
provided with LPG connections under the Pradhan Mantri Ujjawala Yojna (PMUY) scheme.
Chinese company ‘Wanda,’ plans to invest US$ 8.96 billion for strengthening infrastructure facilities in the state of Haryana, by 2020.
Realty firm, Signature Global, signed an agreement with the Government of Haryana in January 2017, for investing US$76.92 million
to develop two housing projects in Gurgaon.
2626MARCH 2017
Name of project Sector
Project cost
(US$ million)
Stage
Road upgradation (Punjab/Haryana Border-Jind) Project Roads & bridges 77.95 Under construction
Construction of Kundli Manesar Palwal Expressway Roads and bridges 388.97 Under construction
Amusement park at Gurgaon
Social & commercial
infrastructure
15.28 Under construction
Construction of 4 laned ROB including its approach on
Delhi Agra Railway Line near Bata Chowk
Roads and bridges 3.67 Operational
Unitech SEZ at Kundli, Sonipat
Social & commercial
infrastructure
3,362.37 Under construction
Installation of 100 Reverse Osmosis Plants in 100 villages Water treatment plants 1.72 Under construction
Development of Industrial Park, Gurgaon
Social & commercial
infrastructure
9.17 Operational
Hotel Management Institute (Badhkal) Education 6.11 Operational
Source: Department of Economic Affairs, Government of India; TechSci Research
For updated information, please visit www.ibef.org
DEVELOPMENT PROJECTS: KEY PUBLIC-PRIVATE PARTNERSHIP (PPP) PROJECTS … (1/2)
HARYANA THE BREAD BASKET OF INDIA
2727MARCH 2017
S No
Some of the promoters of SEZs:
Planned or under construction
1 Perpetual Infracon Pvt Ltd at Faridabad
2
Pioneer Urban Land and Infrastructure
Limited
3 G.P. Realtors Private Limited
4
Ansal Colours Engineering SEZ at District
Sonipat
5 DS Realtors Private Limited
6
Natasha Housing & Urban Development Ltd
at Panipat
7 Orient Craft Infrastructure Limited
8 DLF Ltd.
As of July 2016, the state had 7 operational SEZs, 23
formally approved SEZs, 3 SEZs with principal approval &
20 notified SEZs.
25 proposals have been granted in-principle/formal approval
in the state by the Government of India.
The state granted industrial colony licences to SEZs. Under
the policy, 15% of land can be developed as residential
area, 45% for industrial units and 5% for commercial use.
The remaining 35% will be left for roads, infrastructure
services and public utilities, apart from open spaces.
In order to increase job opportunities in rural areas and set
up industries, the Government of Haryana identified 32
blocks in the rural areas of Haryana for industrial
development.
For updated information, please visit www.ibef.org
DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (1/5)
HARYANA THE BREAD BASKET OF INDIA
Source: Ministry of Commerce & Industry, Government of India,
2828MARCH 2017
Source: Government of Haryana
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (2/5)
The state government has approved, in principle, the setting up of an SEZ near Garhi Harsaru in Gurgaon district.
The Garhi Harsaru SEZ would be utilised only for industrial purposes and cost US$ 341.74 million.
The SEZ aims to promote FDI and resultant exports. The focus is on providing a hassle-free environment for export-oriented
production.
The proposed SEZ would be a duty-free enclave & a deemed foreign territory, where no licence would be required for
imports.
The import of capital goods, raw materials and consumables as well as their procurement from the domestic market to the
SEZ would be exempted from customs duty and central excise duty.
The supplies from domestic tariff area (DTA) to SEZ units would be treated as deemed exports.
Through the automatic route, 100% FDI in the manufacturing sector would be allowed for projects set up in the SEZ.
The SEZ units would be provided in-house customs clearance, and no separate documentation would be required for
customs and Exim Policy.
2929MARCH 2017
Source: Ministry of Commerce & Industry
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA

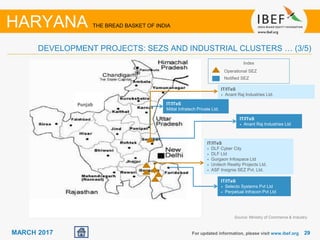

DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (3/5)
IT/ITeS
• DLF Cyber City
• DLF Ltd
• Gurgaon Infospace Ltd
• Unitech Reality Projects Ltd.
• ASF Insignia SEZ Pvt. Ltd.
IT/ITeS
• Selecto Systems Pvt Ltd
• Perpetual Infracon Pvt Ltd
IT/ITeS
• Anant Raj Industries Ltd
IT/ITeS
Mittal Infratech Private Ltd.
Index
Operational SEZ
Notified SEZ
Punjab
IT/ITeS
• Anant Raj Industries Ltd.
3030MARCH 2017
Source: Ministry of Commerce & Industry
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (4/5)
IT/ITeS
• DLF Ltd.
• Dr Fresh Health Pvt Ltd
• DLF Cyber City Developers Ltd
• Gurgaon Infospace Ltd.
• Mayar Infrastructure Development
Private Limited
• Metro Valley Business Park Pvt
Ltd
• Goldsouk International Gems &
Jewellery SEZ Pvt. Ltd.
• ASF Insignia SEZ Private Limited
• Unitech Realty Projects Ltd
• Ascendant Estates Pvt Ltd
• Orient Craft Infrastructure Limited
• G P Realtors Pvt Ltd
Handicrafts: Natasha Housing &
Urban Development Limited
Agro and Food Processing: Ansal Colors
Engineering SEZ Limited
Biotechnology: Mayar Infrastructure
Development Ltd
SEZ (Notified) in Gurgaon
Punjab
3131MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (5/5)
Index
Textiles and handlooms
Automotive
Engineering
IT and ITeS
Petrochemicals
Agro-based industry
Industry clusters in Haryana
Punjab
3232MARCH 2017 For updated information, please visit www.ibef.org
Source: Department of Information Technology, Government of Haryana
GURUGRAM WORLD BPO HUB
The Gurugram district is divided into 3 sub-divisions:
Gurugram North, Gurugram South and Pataudi, which are
further divided into 5 tehsils, namely, Gurugram, Sohna,
Pataudi, Farukh Nagar, Manesar.
Gurugram city, also known as a World BPO hub, serving
industries like IT & ITES, Pharmaceuticals , FMCG etc., has
provided direct and indirect employment to over 10 lakh
people. IT and ESDM sector has proven to be the epicenter
of city’s economic growth.
Gurugram has a base of more than 450 companies
employing 4,000 expats.
Real estate is a major contributor in the city’s economy.
Retail is an important sector in Gurugram, with 26
operational shopping malls.
Gurugram Development Authority was founded in the year
2016, and covers a total area of 1,258 km2.
In collaboration with NASSCOM, Gurugram is planning to
set up a warehouse incubation centre of excellence cum
innovation campus in hub and spoke model with an
investment of US$ 0.61 million and operational expenditure
of US$ 0.15 million, for a duration of 3 years.
ECONOMIC SNAPSHOT
Fact File of Gurugram
Global BPM workforce 5%
Country BPM Workforce 13%
Contribution to State’s GDP 10%
Contribution to Haryana’s Exports 54%
1,244.70
4,053.64
6,817.98
580.08
1,029.71
1,624.78
2004-05 2008-09 2011-12
Gurgaon Haryana
Per-capita income (at current prices), US$
Source: Haryana Government Press Release
3333MARCH 2017
Literacy rate (%) (2015-16)
Total 75.55
Male 84.06
Female 65.94
The state has a strong primary education infrastructure, with a primary
school located within a 1.03-km radius of each village & a middle school
within a 1.07-km radius. As of 2015, there was 1 higher secondary & 1
senior secondary school within a 1.52-km & 2.28-km radius, respectively.
In the 2016-17 budget, US$ 1.99 billion has been allocated for improving
the education sector. For provision of funds to universities, the state
government launched a centrally sponsored scheme, Rashtriya Uchchatar
Shiksha Abhiyan (RUSA), for which US$ 25.35 million has been allocated
during 2016-17.
During 2015-16, the state witnessed the initiation of five new government
colleges. Further, the state government also passed a bill for setting up the
PDM University at Bahadurgarh during 2015-16.
Moreover, an allocation of US$ 251.98 million and US$ 139.81 million has
also been proposed by the state government for higher education and
technical education, respectively, during 2016-17.
The major flagship programmes being undertaken in the state include
Rashtriya Madhyamik Shiksha Abhiyan (RMSA) and Sarv Shiksha
Abhiyan (SSA). Other programmes for the upgradation of education
sector in the state include Beti Bachao Beti Padhao (B3P), Haryana Ek
Khoj under SSA, etc. For RMSA, SSA and Dual Desk Scheme, the state
government has allotted investments of US$ 82.18 million, US$ 120.07
million and US$ 32.73 million respectively.
For updated information, please visit www.ibef.org
SOCIAL INFRASTRUCTURE – EDUCATION
HARYANA THE BREAD BASKET OF INDIA
No of educational institutions (2015)
Universities 27
Colleges 976
Medical colleges 7
Engineering colleges 2,393
MBA colleges 190
MCA colleges 51
Industrial Training Institutes (ITIs) 224
Primary schools 8,899
Middle schools 2,395
Higher & Senior Secondary schools 3,210
Source: Haryana at a Glance, Government of Haryana website, AICTE, National Health Portal, TechSci Research
MBA: Master of Business Administration, MCA: Master of Computer Applications
Source: Economic Survey of Haryana, 2015-16
3434MARCH 2017
Source: Annual Budget 2016-17, Sample Registration System (SRS)
Bulletin 1September 2015, 2Per thousand persons, 3Per thousand live births
Health indicators (2015-16)
Birth rate
2
21.3
Death rate
2
6.3
Infant mortality rate
3
41
Life expectancy at birth (years)
Male (2011-15) 68.9
Female (2011-15) 71.3
As of December 2015, Haryana had 152 community health centres,
591 primary health centres, 2,812 sub-centres, 23 sub district
hospitals and 27 district hospitals. As of 2015, the state had 67
Employees State Insurance (ESI) dispensaries. In the 2016-17
annual budget, US$ 598.37 million was allocated for health
services, including medical education & family welfare.
During 2015-16, work on construction of Kalpana Chawla Medical
College at Karnal was under process. The college is being set up at
a total cost of US$ 98.65 million.
As per the state budget 2016-17, the state government is planning
to establish new institutes and medical colleges in the state during
2016-17, which include Health University in Kutail district of Karnal,
a new AIIMS (All India Institute of Medical Sciences) in Manethi
village, a National Cardiovascular Institute at Badhsa village, as well
as the medical colleges in Jind, Pinjore and Bhiwani.
Further, the state government has also decided to set up an AYUSH
University as well as AYUSH Cell across every PHC of the state.
The health infrastructure of the state during 2015-16 includes 458
Ayurvedic dispensaries, 3 Ayurvedic hospitals, 6 Ayurvedic
Prathmic Swasthya Kendras, 1 Unani Hospital, 18 Unani
Dispensaries, 1 Institute of Indian Systems of Medicine & Research
& 20 Homoeopathic Dispensaries.
The state government is planning to make dialysis a more
affordable & accessible medical procedure for people by increasing
the number of dialysis centres in the state to 10 centres from the
existing 4 centres.
For updated information, please visit www.ibef.org
SOCIAL INFRASTRUCTURE – HEALTH
HARYANA THE BREAD BASKET OF INDIA
Allocation, release and utilization under NHRM
(US$ million)
47.98 52.02 52.66
41.36
49.48 52.41
45.39
32.82
61.32
70.30 72.69
2012-13
2013-14
2014-15
2015-16¹
Allocation Release Expenditure
3535MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
CULTURAL INFRASTRUCTURE
Phag, Dhamal, Ratvai, Khoria, Ghoomar & Ganguar are some of the many dance forms of Haryana. Important festivals of the state are
Lohri, Basant Panchami, Holi, Gangore, Baisakhi, Nirjala Akadashi, Gugga Naumi & Navratri. Fairs held in Haryana include Gopal-
Mochan, Masani, Basdoda, Surajkund and the Kartik Cultural Festival.
Under Rajiv Gandhi Khel Abhiyan (RGKA), a block level stadium worth US$ 0.27 million would be constructed in the state. The outfield
of this stadium, worth US$ 0.13 million, would be built under Mahatma Gandhi National Rural Employment Guarantee Act
(MGNREGA). During 2015-16, various youth activities & programmes were organised by the state government for boosting the sports
sector in the state. Further, the state is also deploying the “Haryana Sport & Physical Fitness Policy 2015”, under which the cash
awards amounting to US$ 7.73 million & US$ 0.35 million have been circulated among 89 medal winners of Asian Games & 71
International medal winners. Moreover, the state government has allocated an amount of US$ 44.84 million for the sports sector during
2016-17.
‘Kingdom of Dreams’, which is India’s 1st live entertainment & leisure destination, is located in Gurgaon. The Epicentre in Gurgaon has
been developed as an arts & culture centre. Some renowned museums in the state include Urusvati Museum of Folklore, Sanskriti
Museum, Museum of Folk & Tribal Art in Gurgaon, Sri Krishna Museum (Kurukshetra) & City Museum (Chandigarh). In the 2016-17
budget, Kurukshetra was recognised under Krishna Circuit by the state government for the enhancement of tourism in the state. In
addition to this, other 5 sites which have been recognized & qualified include Brahma Sarovar, Narkatari, Jyotisar, Amin Kund &
Sannihit Sarovar. For the tourism sector, the state government has allocated US$ 10.2 million during 2016-17.
Prominent stadiums in the state include Tejli Sports Complex (Yamunanagar), Nahar Singh Stadium (Faridabad), Tau Devi Lal Stadium
(Panchkula) & Nehru Stadium (Gurgaon). In 2015-16, in order to improve the sports infrastructure, the Supplies & Disposal Department
of Haryana purchased sports equipment worth US$ 0.15 million under the SC component scheme. Also, for the upgradation of yoga, it
has been declared by the state government that yoga vayayamshalas will be established in across 6,500 villages of the state. Approval
of the recruitment of 7 coaches & 1,000 instructors for yoga by the state government have been achieved during 2015-16.
On the occasion of Golden Jubliee of the state of Haryana, on November 2nd , 2016, India’s Prime Minister launched 3 schemes for the
state of Haryana - Deen Dayal Jan Awas Yojana, Automation of Fair Price Shops & Kerosene Free Haryana
As of February 2017, the state government is planning to organize Surajkund International Crafts Mela twice in a year. Sri Lanka will
also be considered as a partner country for the next edition of the Mela.
Source: Economic Survey 2015-16, State Budget 2016-17
3636MARCH 2017
• Industrial Model Townships (IMT) – Developed
and under developed
• IMT Rohtak
• IMT Faridabad
• IMT Kharkhoda
• IMT Mewat
• IMT Bawal
• IMT Manesar
Historically an agrarian state, Haryana today is a well-
developed industrial state. HSIIDC is the state’s premier
industrial promotion agency. It is responsible for providing
reliable and efficient facilities to entrepreneurs investing in
the state.
The state has taken several initiatives for developing
industrial infrastructure to achieve consistent economic
growth.
HSIIDC has developed a number of industrial estates,
industrial model townships and specialised parks for cluster
development.
Various industrial clusters that have come up across the
state include footwear and accessories in Bahadurgarh,
agricultural implements in Karnal, scientific instruments
cluster in Ambala, handloom, hosiery and textile goods in
Barhi, and fabrication & fitting cluster in Faridabad.
An Industrial Model Township is located in Manesar, on NH-
8. The IMT deals in housing readymade garments,
automobile industries, etc.
For updated information, please visit www.ibef.org
INDUSTRIAL INFRASTRUCTURE
HARYANA THE BREAD BASKET OF INDIA
Source: HSIIDC
National Investment and Manufacturing Zones are
conceived as major integrated industrial townships, that
provide manufacturing industries with a conducive
environment. During 2015-16, Manesar-Bawal Investment
Region of Haryana has been approved as NIMZ in the
country,
Maruti Suzuki announced its plans to invest US$584.61
million in its new R&D center in Rohtak, which is expected
to be operational by 2019.
3737MARCH 2017 For updated information, please visit www.ibef.org
SMART CITIES
In August 2015, 2 cities of Haryana were proposed to be
developed as smart cities. As of May 2015, along with the
selected smart cities, 20 cities of Haryana were selected
for infrastructure development under the AMRUT scheme.
As of July 2015, under the AMRUT scheme, a total fund of
US$ 1.12 million was allocated to Haryana and advance
payment of US$ 0.83 million has already been made.
Source: Census 2011 & TechSci Research
HARYANA THE BREAD BASKET OF INDIA
Faridabad
Karnal
On the basis of scoring, top 20 cities were selected by the
panel of experts, for funding in 2015-16 under Smart Cities
Mission. In addition to these 20 cities, the panel of experts
also listed 23 states which will be provided with a special
fast-track for upgrading their proposals. These states will
be eligible for funding during 2016-17. With a score of
47.86%, Faridabad city of Haryana is also in the list.
Gurgaon
Smart cities in Haryana
Cities Population
Area (sq.
km)
Literacy
rate
Faridabad 1,809,733 741 81.70%
Karnal 1,505,324 1,967 74.73%

3838MARCH 2017
Estate/location Brief description
IMT Manesar
(Phase I is complete, Phases II, III,
IV and V are undergoing
development)
• Located at a distance of 50 km from Delhi on NH-8 & about 32 km from the IGI Airport.
• Focus on hi-tech and hi-precision non-polluting units such as automotive, readymade
garments, ITeS and packaging.
IIDC, Saha (Status- Planned &
Developed)
• Located on NH-10, about 250 km from New Delhi.
• HSIIDC acquired around 76 acres of land for setting up IIDC in Saha.
Udyog Vihar, Gurgaon
• Located on NH-8, about 8 km from IGI.
• Focus on IT/ITeS, electronics, electrical goods, pharmaceuticals, light engineering, auto
parts and components and readymade garment sectors.
• Maruti Udyog, a leading car manufacturer of India, has its base in Udyog Vihar.
Kundli
Phases I, II, IV, EPIP and Electronic
Hardware Technology Park (Status -
Planned & Developed)
• Located on NH-1 on the Delhi-Haryana border, about 20 km from Delhi.
• Has industrial units from general engineering, cycle parts, dairy products & agro-based
sectors.
Faridabad
• Located about 35 km from New Delhi, on the Delhi-Mathura highway.
• Has industrial units for the light engineering sector.
Murthal
• Located about 50 km from New Delhi, on NH-1.
• Has industrial units from general engineering, malt, chemicals & cycle parts sectors.
Panipat (Status - Fully Developed)
• Located about 89 km from New Delhi, on NH-1.
• It covers 922 acres of area and is a well-equipped facility with an internal road network
& electric distribution system.
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
INDUSTRIAL INFRASTRUCTURE – EXISTING INDUSTRIAL ESTATES … (1/2)
Source: HSIIDC website
3939MARCH 2017
Estate/location Brief description

Ambala
• Located about 200 km from New Delhi, on NH-1.
• Has industrial units from scientific instruments, electronic and light engineering sectors.
• It also has a United Nations Development Programme (UNDP) assisted instrument design and development
centre.
Tohana (Status- Planned
& Developed)
• Located about 200 km from New Delhi.
• Has industrial units from agriculture implements, foundry and light engineering sectors.
Jind
• Located about 120 km from New Delhi.
• Has agro-based industries, leather based products and chemical industries
Samalkha (Status-
Planned & Developed)
• Located about 70 km from New Delhi on NH-1
• Has light engineering and foundry units.
Rai (Status- Planned &
Developed)
• Located about 35 km from New Delhi on NH-1.
• A food park and a technology park have been developed here.
Barwala (Phase-l
Completed and Phase-ll
under-construction)
• Located at about 240 km from New Delhi, Panchkula-Saha State Highway, in District Panchkula
• Has industrial units of plywood, pharmaceuticals units and light engineering works.
Other industrial estates under implementation are ancillary estates at Panchkula, Kalka, Murthal, integrated infrastructure development
centre at Sirsa, built-up sheds near Sohna, and estates at Manakpur in Yamuna Nagar.
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
INDUSTRIAL INFRASTRUCTURE – EXISTING INDUSTRIAL ESTATES … (2/2)
Source: HSIIDC website
4040MARCH 2017
Estate/location Brief description
Barhi
(Status- Planned &
Developed)
• Located about 57 km from Delhi on NH-1, near Gannaur in Sonepat District.
• List of key industrial units include Seasons Textiles, Wooltex Textiles, Kaico Deer, EOC
Polymer, etc.
Bahadurgarh
(Sector 18 & 18A)
• Just next to New Delhi on NH-10 linking Delhi with Rohtak and Hissar in District Jhajjar.
• HSIIDC acquired around 138 acres of land for setting up an industrial estate in Bahadurgarh
(Jhajjar district).
Growth Centre, Saha
(Phase-l is completely
planned and
developed; Phase-ll is
planned and under-
construction)
• Located about 180 km from Delhi on NH-73 and is about 15 km from Ambala Cantt
• Key companies include Mount Shivalik Breweries Ltd, Super Filtration System Ltd, Osaw Agro
Industries Ltd, Kandhari Beverages (P) Ltd and Mahaunt Agro (P) Ltd
Hosiery complex in
Barhi (expansion in
planning stage)
• A hosiery and textile park exists in Barhi near Ganaur, in Sonipat district, and an industrial
complex is being planned as part of the expansion.
Three more townships are being planned at Sampla, Badli-Jahangirpur and Ganaur-Samalkha.
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (1/3)
Source: HSIIDC website
4141MARCH 2017 For updated information, please visit www.ibef.org
INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (2/3)
Kundli-Manesar-Palwal (KMP) expressway:
The government is developing sector specific theme parks
and sub-cities along the KMP expressway. The 135-km KMP
expressway will act as a Delhi bypass and provide seamless
connectivity across NH-1, NH-2, NH-8 and NH-10. Total cost
of the project is US$ 414.73 million.
In addition to industrial infrastructure, the project aims to
provide smooth and quick transportation of surplus food
grains, milk products, fruits and vegetables from Haryana,
Punjab, Himachal Pradesh and Kashmir to other parts of the
country.
Source: HSIIDC website
Mega-projects of Haryana
Kundli-Manesar-Palwal (KMP) Expressway on Build-Operate-
Transfer (BOT) basis
Delhi-Mumbai Industrial Corridor (DMIC) Project
Manesar Bawal Investment Region (MBIR)
Early Bird Projects (Global City Project, Integrated Multimodal
Logistics Hub (IMLH), Mass Rapid Transit System Between
Gurgaon-Manesar-Bawal (MRTS)
HARYANA THE BREAD BASKET OF INDIA
Delhi-Mumbai Industrial Corridor (DMIC) Project:
The 1,500-km Delhi-Mumbai Industrial Corridor (DMIC)
project worth US$ 90 billion will serve as a dedicated
freight corridor between Delhi and Mumbai.
The project plans to create self sustaining industrial
townships within the corridor. These townships would be
served by multi-modal connectivity for freight movement
as well as reliable power and air connectivity.
The project incorporates Nine Mega Industrial zones of
about 200–250 sq km area, high-speed freight line, three
ports and six airports; a six-lane intersection-free
expressway connecting the country’s political and
financial capitals and a 4,000-MW power plant.
The corridor is expected to create 2.5 million new jobs.
The DMIC covers nearly 14 districts of Haryana – 66% of
the state’s total area.
International Cargo Airport at Bhaini Maharajpur & Bhaini
Bhairon villages is a greenfield project located at the tri-
junction of Rohtak, Hisar and Bhiwani districts. The
proposed airport would be about 110 km from New Delhi’s
IGI Airport.
4242MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (3/3)
Manesar Bawal Investment Region (MBIR):
The 800 square km Manesar Bawal Investment Region (MBIR) would provide investment opportunities alongside NH-1, NH-
2, NH-8 & NH-10. With this, the government aims at developing urban, industrial and economic infrastructure in the state.
The planned residential population of MBIR is 3.20 million, employment potential of 1.6 million and industrial output value of
US$ 50 billion.
During 2015-16, the master plan notification for the region has been completed and Ministry of Environment, Forest and
Climate Change (MoEFCC) has also obtained the environmental clearance for the region. Moreover, the plan for integrated
water resources management for the region has also been decided.
Early Bird Projects:
Global City Project: This 1,100 acres project located in Gurgaon is expected to be the biggest facility in the country. This
project would cater to the hospitality sector and meet the business needs of the corporates and public enterprises.
Integrated Multimodal Logistics Hub (IMLH): The 900 acres project located in district Rewari is worth US$ 500 million.
This project is expected to be the union point for cargo movement from Punjab, NCR, Haryana and Rajasthan.
Mass Rapid Transit System Between Gurgaon-Manesar-Bawal (MRTS): The 130 km MRTS aims to provide connectivity
between Gurgaon, Manesar, Dharuhera and Bawal. This includes connection of 57 stations with Delhi Metro and is
expected to carry 1.16-2.24 million passengers per day by 2040.
Source: HSIIDC website
4343MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES
Haryana’s natural resources, policy incentives and
infrastructure support investments in sectors such as
automobiles and auto components, IT/ITeS, textiles,
agro-based industries, business tourism and
commerce. Forming industrial clusters and developing
infrastructure has been the state’s key strategy to
attract investments in various industries.
Haryana State Industrial and Infrastructure
Development Corporation would continue to assist in
the development of the private sector and joint industrial
units in the state.
FIPB (Foreign Investment Promotion Board) provides
technical support for evaluating the proposals for
foreign investment along with decisions related to land
allotment and loan sanction among others.
During 2015-16, the state government employed a new
policy – Haryana Enterprises Promotion Policy-2015,
for providing people with a cost effective environment
for executing their business, endorsing
entrepreneurship, innovation, etc.
As per state budget 2016-17, the allocated budget for
industries and minerals sector was US$ 126.61 million. Source: Haryana Economic Survey 2015-16, State Budget 2016-17
DIPP, 1During April-October 2015
Key industries in Haryana
• Automotive
• Agro-based
industry
• IT/ITeS
• Textiles
• Oil refining
• Bicycles
• Sanitary ware
• Scientific instruments
• Tourism
• Real estate & construction
• Biotechnology
• Petrochemicals
Year IEMs filed
Proposed investments
(in US$ million)
2010-11 141 1,731.25
2011-12 118 1,457.70
2012-13 115 977.77
2013-14 106 692.10
2014-15 70 444.76
2015-16
1
76 449.73
4444MARCH 2017
Haryana is a preferred destination for auto majors and auto-
component manufacturers. The state is host to many large
automotive players.
The state produces two-thirds of passenger cars, 50% of tractors,
60% of motorcycles and 50% of the refrigerators manufactured in
the country.
A significant percentage of the state’s workforce is engaged in
the automotive industry; Gurgaon & Faridabad are important
automobile centres.
The International Centre for Automotive Technology (ICAT) has
been set up at Manesar as a part of the National Automotive
Testing & Research & Development (R&D) Infrastructure Project
(NATRiP). It provides testing & R&D services to the industry.
In March 2016, Honda Motorcycle & Scooter India Pvt. Ltd.
launched its CD 110 Dream Deluxe with self start feature in
Manesar.
The state government has proposed a sliding railway & logistics
centre in IMT Manesar for smoother transportation & more
effective inventory management.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – AUTOMOTIVE INDUSTRY … (1/2)
HARYANA THE BREAD BASKET OF INDIA

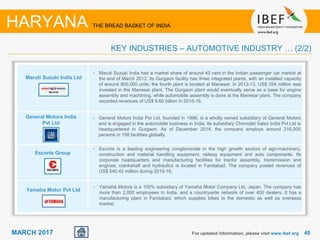

Some of the key players
• Maruti Suzuki India Ltd
• Yamaha Motor Pvt Ltd
• Escorts Group
• General Motors India Pvt Ltd
Source: Haryana Economic Survey, 2015-16
4545MARCH 2017
Maruti Suzuki India Ltd
General Motors India
Pvt Ltd
Escorts Group
Yamaha Motor Pvt Ltd
For updated information, please visit www.ibef.org
• Maruti Suzuki India had a market share of around 40 cent in the Indian passenger car market at
the end of March 2012. Its Gurgaon facility has three integrated plants, with an installed capacity
of around 900,000 units; the fourth plant is located at Manesar. In 2012-13, US$ 354 million was
invested in the Manesar plant. The Gurgaon plant would eventually serve as a base for engine
assembly and machining, while automobile assembly is done at the Manesar plant. The company
recorded revenues of US$ 8.60 billion in 2015-16.
• General Motors India Pvt Ltd, founded in 1996, is a wholly owned subsidiary of General Motors
and is engaged in the automobile business in India. Its subsidiary Chevrolet Sales India Pvt Ltd is
headquartered in Gurgaon. As of December 2014, the company employs around 216,000
persons in 158 facilities globally.
• Escorts is a leading engineering conglomerate in the high growth sectors of agri-machinery,
construction and material handling equipment, railway equipment and auto components. Its
corporate headquarters and manufacturing facilities for tractor assembly, transmission and
engines, crankshaft and hydraulics is located in Faridabad. The company posted revenues of
US$ 540.42 million during 2015-16.
• Yamaha Motors is a 100% subsidiary of Yamaha Motor Company Ltd, Japan. The company has
more than 2,000 employees in India, and a countrywide network of over 400 dealers. It has a
manufacturing plant in Faridabad, which supplies bikes to the domestic as well as overseas
market.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – AUTOMOTIVE INDUSTRY … (2/2)
4646MARCH 2017

Gurgaon has emerged as a preferred destination for the IT
industry in North India, with more than 400 IT & ITeS
companies. The government has granted licenses to 50
proposals for establishment of IT/cyber projects as of
August 2015.
Haryana is among the leading states in terms of IT exports.
As of September 2015, Gurgaon accounted for a share of
around 9% in the overall software exports from the country.
The state government has extended various incentives to
companies within the sector, including relaxation in floor
area ratio, rebate on registration, transfer of property
charges & exemption under the Haryana Shop &
Commercial Act.
Haryana is the 1st state to have implemented its State Wide
Area Network (SWAN) for voice, data & video
transmission. The SWAN vertical connectivity – at the
State Network Management Centre (SNMC), District
Network Management Centre (DNMC) & Block Network
Management Centre (BNMC) – is completed & now
operational.
As of March 2017, the state is strengthening its digital
infrastructure by ensuring rolling out of National Optic Fibre
Network to 4,051 gram panchayats along with providing
Wi-fi to 119 gram panchayats.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – IT/ITES INDUSTRY … (1/2)
HARYANA THE BREAD BASKET OF INDIA
Some of the key players
• IBM Global Process Services
• Tata Consultancy Services (TCS)
• Microsoft Corporation (I) Pvt Ltd
• Google
In the 2016-17 state budget, the Department of Electronics
& IT was allocated a proposed outlay of US$ 12.98 million.
As per Economic Survey 2015-16, in order to fulfil the vision
of digital empowerment of the citizens, the government is
targeting to provide training to around 50 lakh citizens in the
coming 5 years, of which 10 lakh citizens are to be trained
during 2016-17. The total amount of US$ 15.27 million has
been proposed by the state government for this purpose.
Haryana Knowledge Corporation Ltd. HKCL) has set up 205
official learning centres. The state government is targeting
in adding 500 more such centres in the state during 2016-
17.
Source: Haryana Economic Survey, 2015-16, State Budget 2016-17
4747MARCH 2017
IBM Global Process
Services
Tata Consultancy
Services (TCS)
Microsoft Corporation
(I) Pvt Ltd
Google
For updated information, please visit www.ibef.org
• IBM Global Process Services (formerly IBM Daksh) is a leading provider of business process
solutions, with its corporate office in Gurgaon. The company has 23 service delivery centres at
nine locations in India and Philippines and employs more than 100,000 persons, making it one of
the largest Business Process Outsourcing (BPO) vendors in India in terms of headcount. Haryana
was awarded the software centre of excellence by IBM.
• TCS is among the largest providers of IT and BPO services in India. The company’s clients are in
BFSI, healthcare & life sciences, insurance, manufacturing, media, entertainment, transportation,
travel & hospitality, retail, utilities and energy resources sectors. It commenced operations in
Gurgaon in 1995. The company posted revenues of US$ 16.59 billion in 2015-16.
• Microsoft entered India in 1990 and works closely with the Indian government, IT industry,
academia and the local developer community. Microsoft has offices in 10 cities: Ahmedabad,
Bengaluru, Gurgaon, Chennai, Hyderabad, Kochi, Kolkata, Mumbai, New Delhi and Pune.
• In India, Microsoft employs about 5,800 people and has six business units representing the
complete Microsoft product lifecycle. The company has two offices in Haryana, both at Gurgaon.
• Google, a web based search engine, is the flagship product owned by Google, Inc. It offers
special features such as synonyms, weather forecasts, time zones, stock quotes, maps,
earthquake data, movie-show times, airports, home listings and sports scores.
• Google has a sales office in Gurgaon. It is a direct sales organisation and helps the world's
biggest advertisers to enjoy immediate and accountable communication with the consumer. The
sales teams here are structured according to industry verticals.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – IT/ITES INDUSTRY … (2/2)
4848MARCH 2017
Agriculture is one of the biggest employment generators
in rural Haryana, with strong potential in value addition &
exports. Haryana is self-sufficient in food production &
the 2nd-largest contributor of food grains to the central
pool. The Department of Horticulture encourages a
cluster approach for the development of fruit cultivation.
A horticulture terminal market, being developed at
Ganaur, would act as an export hub for fruits, flowers &
vegetables from all over the country.
Haryana aggressively promotes organic farming;
financial assistance is provided to farmers for production
and use of vermicompost. The state government
approved US$ 9.48 million for minor irrigation systems till
January 2016. Furthermore, under National Mission on
Micro Irrigation scheme, the state government has set a
target to cover over 9,588 hectares of area for
horticulture crops.
In January 2016, Haryana State Flood Control Board
sanctioned US$ 19.06 million for 105 new schemes and
US$ 39.23 million for 140 ongoing schemes for flood
control and improving the drainage works.
In February 2017, the state government decided to
constitute a committee of Council of Ministers for
preparing a blueprint of integrated Dairy Complexes in all
cities of the state.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – AGRO-BASED INDUSTRY … (1/3)
HARYANA THE BREAD BASKET OF INDIA
In 2015-16, production of fruits and vegetables in the
state, stood at 384.06 thousand tonnes and 3,547.17
thousand tonnes, respectively. During 2015-16, till
December 2015, the state accounted for an area of
380.91 thousand hectares for horticulture crops. The
total production of horticulture crops in 2015-16 was
4,033.61 thousand metric tonnes
Source: Economic Survey of Haryana, 2015-16
Production of horticulture crops in Haryana
(‘000 MT.)
Crop 2014-15 2015-16
Total fruits 703.67 384.06
Total vegetables 5,285.55 3,547.17
Total spices 81.19 62.44
Total flowers 62.86 38.86
4949MARCH 2017
During 2015-16, under MIDH (Mission for Integrated Development of Horticulture) US$ 11.86 million was allocated for the state, of
which US$ 5.93 million has been released. This mission is undertaken by the state government for holistic development of
horticulture sector, in which a 50:50 contribution would be done by Government of India and state governments.
Under National Horticulture Mission, US$ 10.92 million was allocated for the state and US$ 5.46 million was released, during
2015-16.
Spices production in the state stood at 62.44 thousand MT by the end of December 2015.
According to Haryana Renewable Energy Development Agency (HAREDA), Germany based Verbio AG, has approached the
Haryana government to invest US$ 15 million to develop bio-CNG, from paddy residue in the state.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – AGRO-BASED INDUSTRY … (2/3)
HARYANA THE BREAD BASKET OF INDIA
Source: National Horticulture Board
Haryana total area under cultivation for horticulture
crops (‘000 Ha)
Haryana total production for horticulture crops (‘000 MT)
Source: Economic Survey of Haryana, 2015-16
Note: 2015-16(1) :Till December 2015
434.2
448
440
457
2012-13 2013-14 2014-15 2015-16
5676.1 6,286 6,819 6,337
2012-13 2013-14 2014-15 2015-16
5050MARCH 2017
Nestle India Ltd
GlaxoSmithKline Consumer
Healthcare Ltd (GSK)
Haldiram’s Foods
International Ltd
PepsiCo India
For updated information, please visit www.ibef.org
• Nestle India is a subsidiary of Nestle SA, Switzerland. Its Indian headquarter is in Gurgaon, Haryana.
Its famous brands in India include Nescafé, Maggi, Milkybar, Milo, Kit Kat, Bar-One, Milkmaid,
Nestea, Nestle Milk, Nestle Fresh 'n' Natural Dahi and Nestle Jeera Raita. The company has a
factory at Samalkha, Panipat, which was commissioned in 1993, to manufacture milk products. The
company recorded revenues of US$ 351.74 million during the first quarter of 2016.
• GlaxoSmithKline Consumer Healthcare Ltd (GSKCH) is an Indian group company/associate of
GlaxoSmithKline UK and one of the largest players in the health food & drink industry in India. GSK
has a factory at village Khewra, Sonipat, with a capacity of 26,100 tonnes per annum for its brand
Horlicks. In 2015-16, the revenues recorded by the company stood at US$ 658.22 million.
• Haldiram's started in Bikaner and is one of India's largest sweets and snacks manufacturers. The
company sells packaged food and snacks, which are not only consumed in domestic markets but
also exported to various countries viz., Pakistan, Canada, Australia, Sri Lanka, Singapore, Malaysia,
South Africa, Indonesia, Qatar, Hong Kong, Japan, Kenya, Libya and South Korea. Haldiram’s also
has its own outlets where it sells sweets and eatables. In Haryana, Haldiram Manufacturing Co Pvt
Ltd is located in village Kherki Daula on the Delhi-Jaipur highway.
• PepsiCo established its business operations in India in 1989. The company has a diverse range of
products including carbonated drinks and potato chips. It employs 6,400 people and provides indirect
employment to almost 200,000 people. It has 38 beverage bottling plants and three food plants in
the country. Its corporate office is in Gurgaon.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – AGRO-BASED INDUSTRY … (3/3)
5151MARCH 2017
Abundant availability of raw materials gives Haryana a
competitive advantage in the textile sector – cotton production
in 2015-16 was around 2.6 million bales (bales of 170 kg
each). The average yield and area in 2015-16 was around 700
kg per hectare and 650 thousand hectares, respectively.
Readymade garments worth around US$ 1.3 billion are
exported from Haryana annually, providing employment to
around one million workers.
A cluster of high-fashion readymade garment units has come
up in the well-developed industrial area of Udyog Vihar,
Gurgaon. Panipat, known as the “city of weavers”, has
established itself as a centre for handloom products on the
global map.
In the 12th Five Year Plan, the Ministry of Textiles,
Government of India, launched the ISDS (Integrated Skill
Development Scheme). The aim of this scheme is to train 15
lakh people for skill development. The state of Haryana aims at
training around 20,000 people under this project at an
estimated cost of US$ 3.31 million. The total training cost
would be split in the ratio of 75:25 between the Government of
India and the state government.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – TEXTILES … (1/3)
HARYANA THE BREAD BASKET OF INDIA
Source: Economic Survey of Haryana 2015-16, Ministry of Textiles
Haryana total khadi production (US$ million)
Haryana total khadi sales (US$ million)
The handloom business is expected to receive a further boost
with the establishment of the proposed International Trade and
Convention Centre in Panipat. It will function as a design
centre for the handloom products.
13.17
14.14
2013-14 2014-15
16.41
17.38
2013-14 2014-15
5252MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – TEXTILES … (2/3)
Source: Ministry of MSME
Spun yarn production (2015-16 -
up to September 2015)
Production (‘000 kg) Share (%)
121,659 4.3
Cotton yarn production (‘000 kg)
2014-15 2015-16
214,159 54,859
Funds released under National Handloom Development Programme
(2014-15) – US$ million
Integrated Handloom Development Scheme (IHDS) 0.03
Handloom Marketing Assistance (HMA) 0.02
Diversified Handloom Development Scheme (DHDS) 2.13
Funds Released Under handicraft schemes (2015-16) – US$ thousand
Ambedkar Hastshilp Vikas Yojna (AHVY) 86.77
Design and Technological Up-gradation 3.67
Human Resource Development Scheme 31.55
Total 121.98
5353MARCH 2017
DCM Textiles
Benetton India Pvt Ltd
Orient Craft Ltd
Pearl Global Ltd
For updated information, please visit www.ibef.org
• The company manufactures 100% grey cotton yarn and melange yarn. It has a spinning mill
located in Hisar, with an installed capacity of 74,436 spindles. The company exports to 25
countries, including Spain, Portugal, Egypt, South Korea, Brazil, Hong Kong, Italy and Israel.
• Benetton India is a wholly owned subsidiary of the Benetton Group, Italy. United Colors of
Benetton is among the market leaders in branded apparel, with around 480 stores across 100
cities. The company has a manufacturing unit in Gurgaon.
• Orient is located in Gurgaon and employs around 5,000 people. It has established itself as a
premium exporter of textiles from Haryana people. The company has the combined capacity to
produce nearly 200,000 pieces per day at 21 units across the country.
• Pearl Global Ltd is a subsidiary of House of Pearl Fashions Ltd Group, which is among the
pioneers of the ready-to-wear apparel industry in India.
• The company has six fully integrated manufacturing plants in Gurgaon, with a capacity for
producing value added woven and knitted garments. The total factory area in north India covers
more than 310,000 sq ft. The installed capacity on a single shift basis stands at 10 million pieces
per annum. The units specialise in casual-wear dresses, ladies blouses in both woven and knits.
Important customers of the company include Gap, Inc, JC Penney, Kohls, Next, H&M and Esprit.
Revenue for the year ended March 2016 was US$ 212.87 million.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – TEXTILES … (3/3)
5454MARCH 2017
Panipat Refinery, which is a unit of Indian Oil Corporation Limited (IOCL), was commissioned in 1998 and during 2015-16, the
refinery had a capacity of 15.000 MMTPA . As per refinery operations data for FY2016, the refinery produces diesel and gasoline
which are compliant to BS-IV specifications.
For leveraging the establishment of a petrochemical plastic park and hub at Panipat under vicinity of IOCL, the “Enterprises
Promotion Policy-2015” was launched by Government of India, which became effective in the state from August 2015.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – PETROCHEMICALS … (1/2)
HARYANA THE BREAD BASKET OF INDIA

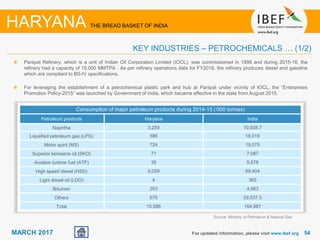

Consumption of major petroleum products during 2014-15 (‘000 tonnes)
Petroleum products Haryana India
Naphtha 3,259 10,938.7
Liquefied petroleum gas (LPG) 586 18,019
Motor spirit (MS) 724 19,075
Superior kerosene oil (SKO) 71 7,087
Aviation turbine fuel (ATF) 35 5,578
High speed diesel (HSD) 5,029 69,404
Light diesel oil (LDO) 4 365
Bitumen 203 4,983
Others 675 29,537.3
Total 10,586 164,987
Source: Ministry of Petroleum & Natural Gas
5555MARCH 2017 For updated information, please visit www.ibef.org
KEY INDUSTRIES – PETROCHEMICALS … (1/2)
HARYANA THE BREAD BASKET OF INDIA
• IOCL manufactures petroleum products, crude oil, lubricants, grease, oil base, additives etc.
• IOCL has a refinery at Panipat, the company’s seventh. The refinery was set up in 1998 at a cost
of US$ 848 million, with a capacity of 6 million metric tonnes per annum (MMTPA). The Panipat
refinery has increased its refining capacity from 6 MMTA to 15 MMTA with the commissioning of
its expansion project.
• Kandla-Bhatinda product pipeline was converted to crude oil service and renamed as Mundra-
Panipat pipeline in 2006. The Mundra-Panipat pipeline augmentation was commissioned in 2009
at a cost of US$ 34.80 million.
• In March 2010, a naphtha cracker complex was set up adjacent to the Panipat refinery at an
investment of US$ 3.04 billion.
• The company recorded total revenues of US$ 54.37 billion for 2015-16.
Indian Oil Corporation
Ltd (IOCL)
5656MARCH 2017
The real estate and construction industry has grown rapidly in Haryana.
The growth in real estate in Haryana encompasses activities in the
residential, commercial and hospitality space. Real Estate
Development Council (REDCO) is the apex body for all stakeholders in
the housing and construction industry; it was launched jointly by the
Government of Haryana and the Ministry for Urban Development,
Government of India. Gurgaon accounts for more than 70% of the new
commercial space coming up in the NCR. Gurgaon is registering the
fastest growth in the real estate sector in India. Owing to Gurgaon’s
reputation as an IT hub and proximity to the national capital Delhi,
demand for both housing and commercial space is rising.
To accommodate further growth, the state has finalised the new
Gurgaon-Manesar Master Plan-2025. The plan allocates land for
developing residential and growth corridors. Adani realty team has tied
up with US-based Brahma Management for a 150 acre township in
Gurgaon. New Gurgaon is one of the top realty destinations, with its
world-class infrastructure, amenities and connectivity with neighbouring
states. Gurgaon-Sohna road is another big site for commercial as well
as residential development.
In June 2015, the central government launched the Atal Mission for
Rejuvenation and Urban Transformation (AMRUT). Under this, 19 cities
have been selected in the state, namely Ambala Urban Agglomeration,
Hisar, Bahadurgarh, Ambala Municipal Corporation, Bhiwani, Gurgaon,
Faridabad, Jind, Kaithal, Karnal, Palwal, Panipat, Panchkula, Rewari,
Rohtak, Thanesar, Yamunanagar and Sonepat.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – REAL ESTATE AND CONSTRUCTION … (1/2)
HARYANA THE BREAD BASKET OF INDIA
As per the 2016-17 budget of Haryana, the state
government has proposed an allocation of US$
22.91 million under the state’s scheme of “Housing
for All”. Further, the state government also
implemented Deen Dayal Jan Awas Yojana in the
state for boosting the development of colonies
plotted with high density.
With the transparent and liberal New Integrated
Licensing Policy in the state, the state government
is aiming to provide houses to all the people at
economical prices as per the budget 2016-17.
The progress of clearances on Renuka and Kishau
dams is in its advanced stage. With completion of
these projects, the state is expected to get regular
water supply from the Yamuna.
Source: State budget 2015-16, economic survey 2015-16,
5757MARCH 2017
DLF Ltd
Unitech Group
Ansal Housing &
Construction Ltd
Emaar MGF Land Ltd
For updated information, please visit www.ibef.org
• DLF Group is one of the largest real estate players in India. Its primary business is development
of residential, commercial and retail properties. DLF has been in the industry for over 60 years,
having developed homes, offices, malls, SEZs, hotels and infrastructure projects. In 2015-16, the
company garnered US$ 1.5 billion in revenues.
• In August 2009, the foundation stone was laid for the first private metro rail project in the country.
It is to be developed in Gurgaon by the DLF-IL&FS consortium. The 6.1-km rapid metro rail
project has commenced trial runs and would be commercially operational in a few months. In
November 2013, Phase-I got operational and Phase-ll is expected to get operational by the end
of 2015.
• Unitech is among the largest real estate players, which have executed projects in Gurgaon with
world-class service facilities. Its projects include Nirvana Country, Unitech World, Unitech Trade
Centre, Unitech Business Park, Millennium Plaza (jointly developed with Vipul), Signature Towers
and Global Business Park (jointly developed with Vipul).
• In 2015-16, the company registered revenues of US$ 306.68 million.
• Ansal Group expanded its activities from real estate development to high-value construction. In
2015-16, the company posted revenues of US$ 68.51 million.
• It is present in Gurgaon through several projects in both residential and commercial spaces.
• The group presently employs over 5,000 persons.
• Emaar MGF is a joint venture between Emaar Properties PJSC Dubai, a leading global real
estate company, and MGF Development Ltd, one of the leading real estate developers.
• The company has several housing and commercial projects in the state.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – REAL ESTATE AND CONSTRUCTION … (2/2)
5858MARCH 2017
The Government of India selected Haryana for the
establishment of a biotechnology park along with
R&D facilities, besides promoting the establishment of
a pharma industrial park.
The state government acquired 1,000 acres of land
for a dedicated pharma park in the KMP (Kundli-
Manesar-Palwal) express global economic corridor.
Establishment of research centres and laboratories in
collaboration with the private sector is being
encouraged.
The state government has established a Regional
Centre for Biotechnology (RCB), Gurgaon under the
guidance of UNESCO as a Category II Centre. This
centre was established for education, training, and
research in biotechnology and undertakes
contemporary research at the interface of various
disciplines. The centre started functioning in its
permanent campus in Faridabad, Haryana in January
2015.
For updated information, please visit www.ibef.org
KEY INDUSTRIES – BIOTECHNOLOGY … (1/2)
HARYANA THE BREAD BASKET OF INDIA
Key players
• Proagro Seeds Company Pvt Ltd
• Eli Lilly Company (India) Pvt Ltd
• Sun Pharma
• Venus Remedies Ltd
During 2015-16, various science fairs and exhibitions took
place in the state. Moreover, during 2015-16 (up to October
2015), a total of 24,815 INSPIRE awards were sanctioned
to the state.
5959MARCH 2017
Proagro Seeds
Company Pvt Ltd
Eli Lilly and Company (I)
Pvt Ltd
Venus Remedies Ltd
For updated information, please visit www.ibef.org
• Proagro Seeds Company Pvt Ltd, a leading seed company in India, is a Bayer CropScience
Group company. It is engaged in breeding, development, production and marketing of high
quality hybrid field seeds.
• The company has a biotech laboratory in Gurgaon where genetic markers, DNA finger printing
and other testing techniques are used to support the company’s plant breeding efforts.
• Eli Lilly and Company (India) Pvt Ltd is a subsidiary of the US pharmaceutical major Eli Lilly and
Co. Its primary focus is on diabetes, oncology, acute coronary syndrome, critical care,
osteoporosis and growth hormones, and employs more than 550 people across India.
• In India, Eli Lilly operates in Gurgaon and conducts clinical trials of biotech drugs with its overall
range.
• Venus Remedies Ltd is among the 10 leading fixed-dosage injectable manufacturers worldwide.
The company has presence in 60 countries and covers more than 75 products. The company
registered revenues of US$ 63.90 million in 2015-16.
• The company’s' first manufacturing unit commenced operations in 1991 in Panchkula, Haryana. It
manufactures products in the categories of antibiotics, Total Parenteral Nutrition (TPN), neuro
and other super-specialty therapeutic segments at its Panchkula unit.
HARYANA THE BREAD BASKET OF INDIA
KEY INDUSTRIES – BIOTECHNOLOGY … (2/2)
Sun Pharmaceutical
Industries Ltd
• Sun Pharmaceutical Industries Ltd, one of India's largest pharmaceutical companies, is an
integrated, research-based pharmaceutical company with a global presence. The company
recorded revenues of US$ 4.31 billion in 2015-16. The company announced the acquisition of
Ranbaxy Laboratories Limited in April 2014, and completed the acquisition deal in March 2015.
The company manufactures a wide range of generic medicines in its 45 manufacturing sites
across the globe. Sun Pharma Industries Ltd has two manufacturing facilities in Madhya
Pradesh at Dewas and Malanpur.
6060MARCH 2017
Single-window clearance mechanism was established under the Haryana Industrial Promotion Act, 2005. It has a three-tier
structure to grant exemption/relaxation from any of the provisions/rules of the Act.
The Investment Promotion Centres (IPC) located in New Delhi and Chandigarh and District Industries Centres (DIC) at the
district level serve as nodal agencies and provide support to the committees.
For updated information, please visit www.ibef.org
SINGLE-WINDOW CLEARANCE MECHANISM
HARYANA THE BREAD BASKET OF INDIA
Investment
handled
Under the
Chairmanship of
Nodal
agencies
Greater than
US$ 6.5
million
US$ 1.09 to
US$ 6.5
million
Less than
US$ 1.09
million
High-
Powered
Clearance
Committee
State-Level
Clearance
Committee
District-Level
Clearance
Committee
Principal
Secretary to
Chief Minister
Principal
Secretary
Industries
Deputy
Commissioner
Investment
Promotion
Centre (IPC)
– State Level
District
Industries
Centre (DIC)
– District
Level
6161MARCH 2017
Agency Description
Haryana State Industrial and
Infrastructure Development Corporation
Ltd (HSIIDC)
• Focusses on the development of medium- and large-scale industries.
• Provides financial assistance by way of term loans, equipment re-finance,
equipment leasing and working capital.
Haryana Agro Industries Corporation
Ltd (HAIC)
• Engaged in trading activities such as sale of seeds, fertilisers, pesticides,
tractors and other agricultural machinery at economical prices to the farming
community.
Haryana State Electronics Development
Corporation Ltd (HARTRON)
• Nodal agency of the Government of Haryana for promoting electronics and IT
industries.
• It offers expertise in infrastructure development as well as promotion of
projects.
Haryana Urban Development Authority
(HUDA)
• Responsible for promoting and securing development of urban areas;
activities include land acquisition, development and sale of property for
residential, industrial and commercial purposes.
Haryana Finance Corporation (HFC)
• Meets the credit needs of small- and medium-scale industrial units by
advancing term loans.
For updated information, please visit www.ibef.org

HARYANA THE BREAD BASKET OF INDIA
KEY INVESTMENT PROMOTION OFFICES
6262MARCH 2017
Agency Contact information
Haryana State Industrial and Infrastructure
Development Corporation Ltd (HSIIDC)
Plot No C-13-14, Sector 6,
Panchkula-134109
Phone: 91-172-2590 481
Fax: 91-172-2590 474
E-mail: info@hsiidc.org
Website: www.hsiidc.org
Haryana Urban Development Authority (HUDA)
C-3, Sector-6,
Panchkula
Phone: 91-172-2567 857
E-mail: huda@hry.nic.in
Website: www.huda.gov.in
Haryana Finance Corporation (HFC)
Bays 17-18-19, Sector 17-A,
Chandigarh-160017
Phone: 91-172-2702 755-57
Fax: 91-172-2702 666
E-mail: mdhfc@airtelmail.in
Website: www.hfcindia.org
Haryana State Electronics Development Corporation
Ltd (HARTRON)
SCO-109-110, Sector 17-B,
Chandigarh -160017
E-mail: hartron@hartron.org
Website: www.hartron.org.in
For updated information, please visit www.ibef.org

HARYANA THE BREAD BASKET OF INDIA
CONTACT LIST
6363MARCH 2017
Approvals and clearances required Department Estimated time
Site clearances and No-objection
Certificate
Department of
Environment/Haryana
Pollution Control Board
Site and/or environment clearance: 60 days
No-objection certificate to establish: 7 days
No-objection certificate to operate: 30 days
Renewal of consent: 21 days
Approval, No-objection Certificate
and change of industrial land
Department of Town and
Country Planning
Change of land use in industrial zone: 30 days
No objection certificate for establishment of
industrial unit under the Urban Area Act: 15 days
Approval of building plan: 30 days
Approval and licence
Labour Department/ Chief
Inspector of Factories
Approval of factory plan under the Factories Act,
1948 (Act 63 of 1948): 90 days
Licence for running factory: 15 days
Release of power connection
Uttar Haryana Bijli Vitran
Nigam/Dakshin Haryana
Bijli Vitran Nigam
Load up to 20 KW: 21 days
Load up to 70 KW: 45 days
Load above 250 KW: 60 days
Load above 1 MW: 60 days
Sales tax Excise and Taxation Sales tax registration: 15 days
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
KEY APPROVALS REQUIRED

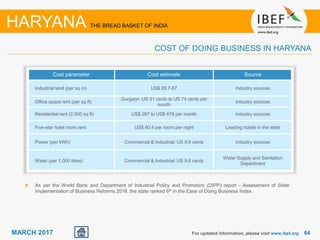

6464MARCH 2017
Cost parameter Cost estimate Source
Industrial land (per sq m) US$ 28.7-67 Industry sources
Office space rent (per sq ft)
Gurgaon: US 31 cents to US 74 cents per
month
Industry sources
Residential rent (2,000 sq ft) US$ 287 to US$ 478 per month Industry sources
Five-star hotel room rent US$ 80.4 per room per night Leading hotels in the state
Power (per kWh) Commercial & Industrial: US 9.6 cents Industry sources
Water (per 1,000 litres) Commercial & Industrial: US 9.6 cents
Water Supply and Sanitation
Department
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
COST OF DOING BUSINESS IN HARYANA
As per the World Bank and Department of Industrial Policy and Promotion (DIPP) report - Assessment of State
Implementation of Business Reforms 2016, the state ranked 6th in the Ease of Doing Business Index.
6565MARCH 2017
Haryana Sports and Physical Fitness Policy 2015
• The policy aims at two themes, namely - Sports for All and Excellence in Sports
• The policy covers five major goals such as - introduction to sports, recreational sports,
competitive sports, high performance sports and sports for development
Read more
Objectives
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA

STATE ACTS & POLICIES … (1/4)
New Integrated Licensing Policy (NILP) 2015
• To develop hyper & high potential urban complexes in the state
• To allow real estate developers in setting up projects that are less than 100 acres of area
(According to Government of Haryana) Read more
Objective
Enterprise Promotion Policy, 2015
• The major objectives of this policy is to facilitate ease of doing business in the state, reduction in
cost of doing business in order to attract more number of players, and have an increased focus
on MSMEs
Read more
Objectives
6666MARCH 2017 For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
STATE ACTS & POLICIES … (2/4)
Haryana Special Economic Zone (Amendment) Act 2010
• To amend the Haryana Special Economic Zone Act, 2005.
Read more
Objective
Industrial and Investment Policy 2011
• To achieve higher, sustainable and inclusive economic growth by attracting investments in a
focussed and structured manner in potential areas.
• Encourage private sector investment and promote the manufacturing sector
as a key economic driver
Read more
Objectives
Rehabilitation and Resettlement Policy, 2010
• To smoothen out the land acquisition process under the Land Pooling Scheme.
• To make fair payment of market value as compensation for land to land owners.
Read more
Objectives
6767MARCH 2017
Information Technology Policy (IT Policy) 2000
• To upgrade the standard and quality of administration, particularly in social and public service
sectors.
• To promote IT literacy and education in the state.
• To attract investments in the IT industry and encourage private sector
participation.
Read more
Objectives
Haryana Special Economic Zone (SEZ) Act 2005
• To promote industrial townships with world-class infrastructure and create a conducive
investment climate for export promotion.
Read more
Objective
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
STATE ACTS & POLICIES … (3/4)
Haryana Tourism Policy 2008
• To increase the earnings from tourism inflow at the rate of 10.0% annually.
• To promote sustainable tourism by encouraging a constructive and mutually beneficial
partnership between the public and private sectors for economic development and employment
generation. Read more
Objectives
6868MARCH 2017
Land Pooling Scheme
• To acquire land for development of industrial infrastructure in a planned manner by the HSIIDC.
• To provide land owners with an option to become partners in the development process.
Read more
Objectives
Labour Policy
• To implement labour laws for ensuring proper working conditions and labour standards.
• To improve working conditions for women and eliminate all forms of child labour.
• To train and retain employees and officers.
Read more
Objectives
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
STATE ACTS & POLICIES … (4/4)
Public Private Partnership Policy
• To facilitate private sector participation in upgrading, developing and expanding the state’s
physical and social infrastructure.
Read more
Objective
Industrial Infra Development Scheme
• Formulated in January 2017, to promote uniform regional and sustainable growth across the
state, including in backward areas. Another objective of the scheme is to provide sufficient width
of road connectivity between the nearest states.
Read more
Objective
6969MARCH 2017
Year INR equivalent of one US$
2004-05 44.81
2005-06 44.14
2006-07 45.14
2007-08 40.27
2008-09 46.14
2009-10 47.42
2010-11 45.62
2011-12 46.88
2012-13 54.31
2013-14 60.28
2014-15 60.28
2015-16 65.46
2016-17E 67.23
Average exchange rates
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
ANNEXURE
Source: Reserve Bank of India
7070MARCH 2017
India Brand Equity Foundation (IBEF) engaged TechSci to prepare this presentation and the same has been prepared
by TechSci in consultation with IBEF.
All rights reserved. All copyright in this presentation and related works is solely and exclusively owned by IBEF. The
same may not be reproduced, wholly or in part in any material form (including photocopying or storing it in any
medium by electronic means and whether or not transiently or incidentally to some other use of this presentation),
modified or in any manner communicated to any third party except with the written approval of IBEF.
This presentation is for information purposes only. While due care has been taken during the compilation of this
presentation to ensure that the information is accurate to the best of TechSci and IBEF’s knowledge and belief, the
content is not to be construed in any manner whatsoever as a substitute for professional advice.
TechSci and IBEF neither recommend nor endorse any specific products or services that may have been mentioned in
this presentation and nor do they assume any liability or responsibility for the outcome of decisions taken as a result of
any reliance placed on this presentation.
Neither TechSci nor IBEF shall be liable for any direct or indirect damages that may arise due to any act or omission
on the part of the user due to any reliance placed or guidance taken from any portion of this presentation.
For updated information, please visit www.ibef.org
HARYANA THE BREAD BASKET OF INDIA
DISCLAIMER

Haryana State Report - March 2017

  • 1.
    11MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA MARCH 2017 (As on 31 March 2017)
  • 2.
    22MARCH 2017 ❖ ExecutiveSummary ..................................3 ❖ Advantage State ........................................4 ❖ State Vision 2018 ......................................5 ❖ Haryana – An Introduction …....................6 ❖ Budget 2016-17 ......................................17 ❖ Infrastructure Status ................................18 ❖ Business Opportunities ...........................42 ❖ Doing Business in Haryana ....................63 ❖ State Acts & Policies ...............................64 For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA MARCH 2017
  • 3.
    33MARCH 2017 Forupdated information, please visit www.ibef.org EXECUTIVE SUMMARY HARYANA THE BREAD BASKET OF INDIA Strong economic growth • With an area covering 1.3% of the country, Haryana contributes nearly 3.63% to India’s GSDP. During 2005-16, the state’s GSDP grew at a CAGR of 11.79%. Leading manufacturing hub • Haryana is home to Maruti Udyog Ltd, India’s largest passenger car manufacturer & Hero MotoCorp Ltd, the world's largest manufacturer of 2-wheelers. Under Make in India project, Manesar-Bawal Investment Region has been identified by the Government to be a manufacturing hub. Leading food producer • Haryana is the 2nd-largest contributor of food grains to India’s central pool. • The state accounts for more than 60% of the export of Basmati rice in the country. Growing IT sector • Haryana is the third-largest exporter of software and one of the preferred destinations for IT/ITeS facilities. Infrastructure support • The state invested in the development of world class infrastructure facilities such as special economic zones (SEZs), Kundli-Manesar-Palwal (KMP) global corridor and Delhi- Mumbai Industrial Corridor (DMIC). • Haryana enjoys a locational advantage, with nearly one-third of the state’s area under the National Capital Region (NCR), a prominent trade and consumption centre. • The state has almost 100% connectivity to rural areas, with metalled roads. Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office, Economic Survey of Haryana 2015-16
  • 4.
    44MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA GSDP 2015-16: US$ 75.3 billion Per capita GSDP 2015-16: US$ 2,963.0 ADVANTAGE HARYANA Growing demand Advantage Haryana Leading business hub • Haryana is one of the leading states in terms of industrial production, specially passenger cars, 2-wheelers, mobile cranes & tractors. The Gurgaon-Manesar-Bawal belt is the auto hub of India. • Haryana has emerged as a base for the knowledge industry, including IT & biotechnology. Many large Indian & multinational companies have set up offices in the state due to its high-quality infrastructure & proximity to Delhi. Attractive investment avenues • Haryana has emerged as a manufacturing hub, with immense scope for development of micro, small & medium enterprises (MSMEs) sector. The state adopted a cluster-based development approach to promote industries such as IT, textiles, food & handloom. • The state’s real estate market is attractive & it is a preferred automotive hub. Of the total 250 large & medium OEMs, about 50 are located in Haryana. Policy & infrastructure support • With a stable political environment, successive governments have been committed to creating a progressive environment. • The state offers a wide range of fiscal & policy incentives for businesses under the Industrial & Investment Policy, 2011. It also has sector- specific policies, particularly for IT & tourism. • Haryana has well-developed infrastructure like power, roads & railways. For trade promotion, the state has planned several projects. Rich labour pool • Haryana has a large base of skilled labour, making it an ideal destination for knowledge- based & manufacturing sectors. It also has a large pool for support services. • The state has set up various national level institutions such as Indian Institute of Management (IIM), Indian Institute of Corporate Affairs (IICA), Central Institute for Plastics Engineering & Technology (CIPET) & National Institute of Food Technology & Entrepreneurship & Management (NIFTEM).
  • 5.
    5MARCH 2017 Infrastructure Housing Tourism Economy Irrigation Agriculture Welfare Education •Contain revenue & fiscal deficit. • Commencement of mining & e- taxation projects would reduce revenue deficit. • Ensure availability of affordable housing for all. • Provide financial assistance for construction. • Offer loans at reasonable terms to BPL families. • Improve quality of education and access to schools. • Expand college and university network. • Enhance sports education and infrastructure to prepare people for competing at international & national events. • Fully utilise nature’s endowment. • Create network of business and tourism facilities. • Schemes to develop SC, BC and other vulnerable sections of society. • Healthcare for women and children. • Modernise police department. • Manage surface water resources efficiently. • Improve water availability by pursuing upstream storage dams. • Implement schemes for remodelling, rehabilitate water courses, flood control. • Timely availability of quality feedstock at subsidised rates. • Modernise irrigation systems. • Pursue crop diversification & introduce modern technologies. • Develop IMTs, industrial parks & expand industrial estates • Create E-biz portal to ensure ease of doing business. • Address needs of MSMEs in areas of R&D and technology; develop rail connectivity to airports, etc. HARYANA THE BREAD BASKET OF INDIA STATE VISION 2018 Vision 2018 For updated information, please visit www.ibef.org Source: Government of Haryana
  • 6.
    66MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA FACT FILE Haryana is surrounded by Uttar Pradesh in the east, Punjab in the west, Himachal Pradesh in the north & Rajasthan in the south. The state surrounds the national capital city, New Delhi, from 3 sides. The most commonly spoken languages are Hindi & Punjabi. English is the medium of education in most schools. Gurgaon, Faridabad, Karnal, Ambala, Panipat & Kurukshetra are some of the key districts of the state. The state has 3 major seasons, viz., summer (April-June), monsoon (July-September) and winter (October-March). Source: Economic Survey of Haryana 2015-16 Parameters Haryana Capital Chandigarh Geographical area (sq km) 44,212 Administrative districts (No) 21 Population density (persons per sq km) 573 Total population (million) 25.4 Male population (million) 13.5 Female population (million) 11.9 Sex ratio (females per 1,000 males) 879 Literacy rate (%) 75.5 HARYANA THE BREAD BASKET OF INDIA Source: Maps of India
  • 7.
    77MARCH 2017 Parameter HaryanaAll states Source Economy 2015-16 2015-16 Gross state domestic product (GSDP) as a percentage of all states’ GSDP 3.63 100.0 Directorate of Economics & Statistics of Haryana, Central Statistics Office GSDP growth rate (%) 4.24 8.71 Directorate of Economics & Statistics of Haryana, Central Statistics Office Per capita GSDP (US$) 2,963.0 1,546 Directorate of Economics & Statistics of Haryana, Central Statistics Office Physical Infrastructure Installed power capacity (MW) 8,510.81 305,554.25 Central Electricity Authority, as of August 2016 Wireless subscribers (No) 22,967,344 1,078,422,215 Telecom Regulatory Authority of India, as of October 2016 Internet subscribers (No) 8,300,000 367,480,000 Telecom Regulatory Authority of India, as of September 2016 National highway length (km) 2,622.48 100,087.08 NHAI & Roads and Building Department Airports (No) 8 125 Airports Authority of India For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA HARYANA IN FIGURES … (1/2)
  • 8.
    88MARCH 2017 Parameter HaryanaAll states Source Social Indicators Literacy rate (%) 75.5 73.0 Census, 2011 Birth rate (per 1,000 population) 21.3 21.6 SRS Bulletin Investment FDI equity inflows (US$ billion) 66.991 324.35 Department of Industrial Policy & Promotion, April 2000 to December 2016 Industrial Infrastructure Completed and operational PPP projects (No) 12 1,246 DEA, Ministry of Finance, Government of India, July 2016 Operational SEZs (no) 7 186 Ministry of Commerce & Industry, Department of Commerce, July 2016 For updated information, please visit www.ibef.org HARYANA IN FIGURES … (2/2) HARYANA THE BREAD BASKET OF INDIA Source: 1Includes Delhi, part of UP PPP: Public-Private Partnership, SRS: Sample Registration System
  • 9.
    99MARCH 2017 24.7 28.5 37.6 39.6 47.2 57.1 64.463.6 65.2 72.2 75.3 At current prices, the total GSDP* of Haryana was about US$ 75.3 billion in 2015-16. The state’s GSDP increased at a compound annual growth rate (CAGR) of 11.79 per cent between 2005-06 and 2015-16. Growth was driven by expansion in the services sector, IT/ITeS, real estate, biotechnology and tourism. GSDP of Haryana at current prices (in US$ billion) CAGR 11.79% For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – GSDP HARYANA THE BREAD BASKET OF INDIA Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office GSDP* -Haryana Socio Economic Survey 2015-16
  • 10.
    1010MARCH 2017 24.7 28.4 37.1 38.8 43.3 52.9 60.361.2 64.2 70.8 71.6 At current prices, the net state domestic product (NSDP#) of Haryana was about US$ 71.6 billion in 2015-16. The state’s NSDP expanded at a CAGR of 11.23 per cent between 2005-06 and 2015-16. NSDP of Haryana at current prices (in US$ billion) CAGR 11.23% For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – NSDP HARYANA THE BREAD BASKET OF INDIA Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office NSDP# - Haryana Socio Economic Survey 2015-16
  • 11.
    1111MARCH 2017 1,210 1,569 1,620 1,898 2,261 2,508 2,4362,459 2,723 2,963 2963 The state’s per capita GSDP^ in 2015-16 was US$ 2,963 compared with US$ 1,210 in 2005-06 . The per capita GSDP increased at an average rate of 10.76 per cent between 2005-06 and 2015-16. Per capita GSDP of Haryana at current prices (in US$) CAGR 10.76% For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – PER CAPITA GSDP HARYANA THE BREAD BASKET OF INDIA Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office Per Capita GSDP^ - calculated using GSDP million US$/Population in million
  • 12.
    1212MARCH 2017 1,041 1,413 1,4611,730 2,057 2,284 2,216 2,240 2,670 2,523 2523 The state’s per capita NSDP& in 2015-16 was US$ 2,523.73 compared with US$ 1,041 in 2005-06. Per capita NSDP increased at an average rate of 10.04% between 2005-06 and 2015-16. Per capita NSDP of Haryana at current prices (in US$) CAGR 10.04% For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – PER CAPITA NSDP HARYANA THE BREAD BASKET OF INDIA Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office per capita NSDP& calculated using NSDP million US$/Population in million
  • 13.
    1313MARCH 2017 23.30% 18.20% 32.70% 30.60% 44.00% 51.20% 2004-052015-16 Primary Secondary Tertiary Tertiary sectorµ is the largest contributor to Haryana’s economy. In 2015-16, it contributed 51.2% to the state’s GSDP at current prices. It was followed by the secondary sector at 30.6 per cent. The tertiary sector grew at an average rate of 13.68 per cent between 2004-05 and 2015-16. The growth was led by trade, hotels, real estate, finance, insurance, transport and communications. The secondary sectorµ grew at an average rate of 11.45% between 2004-05 and 2015-16. Its growth was driven by manufacturing, construction, and electricity and gas & water supply. The primary sectorµ grew at an average rate of 9.63% between 2004-05 and 2015-16. GSDP composition by sector For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – PERCENTAGE DISTRIBUTION OF GSDP HARYANA THE BREAD BASKET OF INDIA CAGR 9.63% 13.68% 11.45% Source: Directorate of Economics & Statistics of Haryana, Central Statistics Office Sector-wise %share of GSDPµ -Haryana Socio Economic Survey 2015-16
  • 14.
    1414MARCH 2017 Source: EconomicSurvey of Haryana, 2015-16, Ministry of Agriculture- Department of Agriculture & Cooperation, Government of India, State Budget 2016-17 Wheat, sugarcane, rice, cotton, rapeseed and mustard are key agricultural products of the state. Total food grain production in Haryana stood at 17.34 million tonnes in 2015-16. In 2015-16, the average yield of wheat and rice in Haryana was 4,700 and 3,450 kg per hectare, respectively. For the enhancement and improvement of the agriculture sector, the state government has allocated a total amount of US$ 2.06 billion during 2016-17. As per the budget 2016-17, a new farm insurance scheme has been launched by the state government, namely, “Pradhanmantri Fasal Bima Yojana”, with an allocation of US$ 45.82 million to minimise damages in the farm sector. Further, the state government has also proposed to increase the grant-in-aid to the agriculture university of Haryana by 9.22% i.e. from US$ 51.47 million in 2015-16 to US$ 56.21 million in 2016-17. For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – AGRICULTURAL PRODUCTION HARYANA THE BREAD BASKET OF INDIA Crop Area (‘000 Ha) Annual production – 2015-16 (‘000 MT) Rice 1,200.00 4,140.00 Wheat 2,520.00 11,844.00 Oilseeds 625 1,146.00 Total pulses 61.00 63.00 Total food grains 4,528.00 17,344.00 Onion 16.00 399.85 Potato 33.70 239.34 Tomato 17.69 340.84 Sugarcane 120.00 9,120 Fruits 53.09 384.06 Vegetables 312.81 3,547.17
  • 15.
    1515MARCH 2017 According tothe Department of Industrial Policy & Promotion (DIPP), cumulative foreign direct investment (FDI) inflows from April 2000 to December 2016 were recorded at US$ 66.99 billion. The services sector accounted for a major share in FDI followed by real estate & electricity. During 2015-16, various projects, such as, enhancement in operational efficiency, addition in capacity generation, extension of distribution network, etc. were taken up by the state government for fulfilling the need of power availability maximization in the state. However, during 2016-17, the state government has taken the decision to adopt the scheme of Ujwal Discom Assurance Yojna (UDAY), which is expected to increase the financial as well as operational capacity of Power Corporations of the state. As per the announcements made by the Haryana government, the state received investment offers worth US$ 259.7 million from leading companies in the fields of electronics, solar energy & beverages. In 2017, the government allocated substantial investment for digitization and development of power sectors of Gurugram, in lieu of the steadfast growth of the state and the role of Gurugram towards its development. Source: Department Of Industrial Policy & Promotion, 1Includes Delhi, part of UP For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – FDI INFLOWS & INVESTMENTS HARYANA THE BREAD BASKET OF INDIA FDI equity inflows1, 2008-09 to 2015-16 (US$ million) 4,530 5,071 5,985 6,882 8,114 6,242 6,875 12,743 2008-09 2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16 Companies Investment Offers to Haryana Government PLG Clean Energy Group US$ 198.59 million for production of 250MW solar energy Videocon Group US$ 22.91 million in Haryana Asahi Group, Japan US$ 22.91 million, for setting up a beverage plant Essel Group US$ 15.27 million Source: Economic Times
  • 16.
    1616MARCH 2017 5.6 6.6 7.4 7.6 9.2 10.610.1 11.0 12.6 12.7 Total industrial exports from Haryana increased from US$ 5.6 billion during 2005-06 to US$ 12.7 billion during 2014-15. The setting up of SEZs in sectors like IT/ITeS, biotechnology, handicrafts, etc., has helped increase exports in the state. Haryana is amongst the biggest producers of food grains in India. The state of Haryana accounted for a share of over 14.18% in the overall exports of Basmati rice from India in 2015-16. Source: Department of Economic and Statistical Analysis, Haryana APEDA Exports from Haryana (US$ billion) For updated information, please visit www.ibef.org ECONOMIC SNAPSHOT – EXPORT TRENDS HARYANA THE BREAD BASKET OF INDIA CAGR 9.52% Basmati rice exports from Haryana (‘000 MT) 139.37 205.44 268.15 349.30 475.01 471.94 577.45 2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16
  • 17.
    17MARCH 2017 HARYANA THEBREAD BASKET OF INDIA BUDGET 2016-17 For updated information, please visit www.ibef.org Source: Haryana Budget 2016-17, Department of Finance, Government of Haryana State Budget 2016-17 Sectoral allocation In US$ million Irrigation 330.41 Power 2,570.53 Education 1,992.64 Sports 44.84 Technical education & industrial training 139.81 Health, medical education & family welfare 598.37 Public health engineering 474.85 Social welfare, nutrition & welfare of SCs & BCs 945.59 Industries & minerals 126.61 Transport 376.47 Agriculture & allied services 2,061.41 Social Justice and empowerment 643.19 Roads & buildings 685.16 Rural development 431.48 Urban development 542.17
  • 18.
    1818MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA PHYSICAL INFRASTRUCTURE – ROADS…(1/2) As of December 2015, Haryana has a total road network of 26,016 km out of which 2,622.48 km is constituted by the National Highways and 1,801 km are state highways. Haryana is among the states having almost 100% connectivity to rural areas with metalled roads. Haryana Roadways, with its fleet of nearly 4,215 buses, is one of India’s biggest state road transport undertakings which operate across 12.70 lakh km everyday. As per budget 2016-17, the state government created a new scheme “Expenditure on Road Safety” for enhancing the safety on roads in the state. During 2016-17, various road projects of Dadri, Narnaul, Rewari, Sonepat and Narnaul that have a length of 395 km, are under process for posing to NCRPB for funding. The estimated cost of these projects is recorded to be US$ 162.54 million. The state government sanctioned a work programme for renovation of major district roads, state highways, other district roads, etc. at an amount of US$ 238.31 million during 2015-16. Out of these projects, some are under process while the others are to be taken up during 2016-17. Moreover, the state government has also projected to widen VT roads of 250 km from 3.66 metres to 5.50 metres. Source: Economic Survey of Haryana, 2015-16, Ministry of Road Transport & Highways, Government of India, News articles, NHAI Note: 2015-16(1) : Till December 2015 National highway length completed (km) 92.74 34.48 86.00 2012-13 2013-14 2014-15 Pradhan Mantri Gram Sadak Yojana (PMGSY) was launched in 2000 with the objective of connecting eligible rural habitants. During 2015- 16 (up to October 2015), a total amount of US$ 36.20 million was allocated to the state under PMGSY. Pradhan Mantri Gram Sadak Yojana (PMGSY) (2015-16-up to October, 2015) Length completed 138.82 Expenditure on construction of national highways in Haryana (US$ million) 14.51 8.88 10.03 12.48 2012-13 2013-14 2014-15 2015-16⁽¹⁾
  • 19.
    1919MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA PHYSICAL INFRASTRUCTURE – ROADS…(2/2) Source: Ministry of Road Transport & Highways, National Highway Authority of India, N.A. Not Available Projects under implementation (as of September 2015) Stretch Funded by Phase NH Length (km) Start date Estimated completion date Supervision consultant & nationality • Flyover construction at Bahalgarh ch.41.210 and additional 2-lane bridge construction near Rasoi Ch.32.28 on NH-1 • Km 29.30 to Km 86.0 • NHAI • Misc. Projects 1 56.7 Nov 2014 Nov 2016 Gawar Construction Ltd., Indian • 8-lane construction from Mukarba Chowk to Panipat • Km.15.500 to Km.86.600 • BOT • Misc. projects 1 69.84 N.A. N.A. M/s Essel Infraprojects Ltd- Indian • Bhatinda-Suratgarh (ROB) • NHAI • Misc. projects 32-B N.A. Jan 2014 Apr 2016 Gawar Construction Ltd.- Indian
  • 20.
    2020MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA PHYSICAL INFRASTRUCTURE – RAILWAYS As of August 2015, Haryana had a 1,630-km long rail route. Kalka, Kurukshetra, Rohtak, Jind, Hisar, Ambala, Panipat, Gurgaon & Jakhal are some of the important railway stations. There is a railway workshop at Jagadhari. During 2015-16, the construction of Sonepat-Jind railway line was completed at an estimated cost of US$ 113.19 million, testing of which is under process. Moreover, the land acquisition work of Rohtak- Meham-Hansi railway line is also under process, which is expected to be completed at a cost of US$ 62.02 million. Consequently, the work on shifting of the railway line of Rohtak-Panipat out of the land acquisition by MC Rohtak is also under process. The total cost associated with the project is recorded to be US$ 27.65 million. The state government will provide 50% of the US$ 423.5 million funds for implementing three railway line projects: Delhi-Sohna-Nuh-Ferozpur Jhirka-Alwar (104 km), Hisar-Agroha-Fatehabad-Sirsa (93 km) and Yamunanagar-Sadhora-Naraingarh-Chandigarh (91 km). As per the state budget 2016-17, for the establishment of a rail link between Rohtak, Hansi and Meham, the state government has provided various funds during 2016-17. Railway Ministry declared its plans to set up a new joint venture between the Haryana government and Railways for upgradation of railway stations and strengthening infrastructure in the state. Railways has also signed a MOU with Haryana government regarding the plantation of saplings on vacant land on both sides of railway lines. Source: Economic Survey of Haryana, 2015-16 Source: Maps of India Railway lines in progress (2015) Railway line Project cost (US$ million) Rohtak-Meham-Hansi 62.02 Shifting of Rohtak-Panipat railway line out of MC Rohtak 27.65
  • 21.
    2121MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA PHYSICAL INFRASTRUCTURE – AIRPORTS There is a domestic airport at Chandigarh and civil aerodromes at Pinjore, Karnal, Hissar, Bhiwani and Narnaul. The state has a total of 8 airports, which includes both operational and non-operational airports. An international cargo airport and aircraft maintenance hub is proposed in Rohtak, Haryana. The airport would be built in the PPP mode with HSIIDC. As per the state budget 2016-17, the Chief Minister of Haryana announced to upgrade the Hisar civil aerodrome into an international airport. Under the first phase of construction, the state government is planning to modernise and renovate the buildings of the terminal and expand the runway from 4,000 feet to 6,000 feet, at a total cost of US$ 7.63 million during 2016-17. Also, as per the state budget 2016-17, the civil aerodrome in Karnal is proposed to be upgraded to a domestic airport during 2016-17. Therefore, for the development of civil aviation sector in the state, a total allocation of US$ 13.71 million has been made by the state government during 2016-17. In September 2015, a new terminal at Chandigarh airport was inaugurated. The terminal is capable of handling both domestic and international flights. The cost incurred in the construction of the airport by AAI is US$ 155.77 million. A stake of 51% was taken by the AAI and shares of 24.5% each were held by the state’s of Punjab and Haryana. Source: Economic-Survey, 2015-16 Airports Authority of India, Domestic airport Passengers (lakh) Aircraft movement (‘000) Freight (‘000 MT) 2013-14 2014-15 2015-16 2013-14 2014-15 2015-16 2013-14 2014-15 2015-16 Chandigarh 10.494 12.063 15.340 9.690 10.968 13.130 3.315 5.065 4.559
  • 22.
    2222MARCH 2017 Forupdated information, please visit www.ibef.org As of August 2016, Haryana had a total installed power generation capacity of 8,510.81 MW; of which, 3,813.81 MW is contributed by the state sector, 2240.39 MW by the private sector and 2,456.61 MW by the central sector. Coal-based plants registered a majority share as the capacity stood at 6,087.53 MW as of August 2016. Gas power plants accounted for a power generation capacity of 685.29 MW. Nuclear power plants accounted for a power generation capacity of 109.16 MW. Hydropower plants accounted for a power generation capacity of 1,494.64 MW. Besides, 134.19 MW of installed power generation capacity came from renewable sources. PHYSICAL INFRASTRUCTURE – POWER … (1/2) HARYANA THE BREAD BASKET OF INDIA Installed power capacity (MW) Classification of installed power capacity, by source of power generation (August, 2016) Source: Central Electricity Authority 80% 17% 2% 1% Thermal Hydro Renewable Nuclear 4,630.00 5,071.00 5,985.00 6,882.00 8,114.00 8,665.00 8,753.60 8,510.81 2008-09 2009-10 2010-11 2011-12 2012-13 2013-14 2014-15 2015-16
  • 23.
    2323MARCH 2017 The totalnumber of electricity consumers in the state increased from 35,44,380 in 2001-02 to 55,62,019 in 2015- 16. In annual plan 2015-16, the Government of Haryana proposed an allocation of US$ 1.09 billion for restructuring of power sector in the state. To produce power from bagasse cooperation in sugar mills, 6 projects of 60 MW capacity have been established in cooperative sugar mills of the state in 2015. Furthermore, a 25 MW capacity project at Naraingarh sugar mill is under execution. The state government has proposed to set up around 3,050 solar water pumping systems in the state during 2016-17. In the 2016-17 budget, the state government launched a new scheme “Mhara Gaon Jagmag Gaon” with a view to provide 24x7 supply of power across rural domestic consumers as well. Further, during 2016-17, the government decided to spread the scheme to cover around 260 feeders in the state. Moreover, the state government allocated an amount of US$ 2.57 billion for enhancement of power sector in the state during 2016-17. SPML Infra has got an order worth US$ 37.19 million, for power distribution & transmission in the state. Source: Haryana Power Generation Corporation Ltd; Economic Survey 2015-16; Haryana Budget 2016-17 Proposed projects • 1,500 MW gas-based project at Faridabad • 660 MW capacity thermal unit at Yamuna Nagar • 2,800 MW (4x700 MW) nuclear power plant near Fatehabad • Projects under implementation • 1,320 MW Mahatma Gandhi Thermal Power Project, at Jhajjar • Procurement of 2,113 MW on a long term basis through tariff based competitive bidding For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA PHYSICAL INFRASTRUCTURE – POWER … (2/2)
  • 24.
    2424MARCH 2017 Telecom infrastructure(as of October 2016) Wireless subscribers 22,967,344 Wireline subscribers 354,431 Internet subscribers (1) 8,300,000 Tele density (in %) 84.08 Source: Telecom Regulatory Authority of India; Department of Telecommunications- Ministry of Communications & Information Technology, India Post, TechSci Research 1As of September 2016 GP-Gram Panchayat According to the Telecom Regulatory Authority of India (TRAI), Haryana had nearly 22.96 million wireless subscribers and 354,431 wireline subscribers as of October 2016. The number of internet subscribers in the state as of October 2015, stood at 8.30 million. By the end of October 2016, 9,554,272 subscribers had submitted requests for mobile number portability in Haryana. Moreover, the state of Haryana had a tele-density of 84.08%. In consultation with telecom power companies, Haryana government has rolled out a new Communication and Connectivity Policy to provide a major push to telecom and communication infrastructure in the state. The Department of Telecommunications (DoT) initiated a project in 2011, the National Optical Fibre Network (NOFN), with an aim of providing broadband services to 2,50,000 gram panchayats across the country. By February 2015, 6,097 gram panchayats had access to broadband services in Haryana. For updated information, please visit www.ibef.org PHYSICAL INFRASTRUCTURE – TELECOM HARYANA THE BREAD BASKET OF INDIA Postal facilities (2015-16, up to December 2015) Head post offices 16 Sub post offices 481 Branch post offices 2,180 Total post offices 2,677 Performance status of NOFN (Bharat Net) project (as of April 2016) No. of GPs in Phase-I 6,090 Pipe laid (km) 5,304 Cables laid (km) 4,850 GPs for which cable laid 3,147 No. of Gram Panchayats Lit 160
  • 25.
    2525MARCH 2017 Source: JNNURM,Ministry of Urban Development, Directorate of Urban Local Bodies-Haryana, Economic Survey 2015-16, TechSci Research For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DEVELOPMENT PROJECTS: URBAN INFRASTRUCTURE Under the Urban Infrastructure and Governance (UIG), Jawaharlal Nehru National Urban Renewal Mission (JNNURM), four projects costing US$ 115.97 million have been sanctioned for Faridabad. Under the 12th Five Year Plan & annual plan 2015-16, the proposed outlay for urban development was US$ 332.90 million. Also, US$ 542.17 million has been allocated by the state government for urban & local bodies in the state during 2016-17. A provision of US$ 126.25 million was made under the Rajiv Gandhi Urban Development Mission during 2015-16. During 2015-16, around 212 dwelling units have been completed & around 518 DUs are under progress in the state. Further, as per the state budget 2016-17, the Department of Urban Local Bodies has implemented two warship projects “Swachh Haryana ‐ Swachh Bharat” and “Atal Mission for Rejuvenation & Urban transformation (AMRUT)” in the state. Over 2012-17, the Haryana Infrastructure Development Board plans to implement projects worth more than US$ 920.8 million. Rajiv Awas Yojana (RAY) guidelines were recently modified by the Ministry of Housing & Urban Poverty Alleviation, Government of India. Under the scheme, every citizen would have access to basic shelter, public and social services. Under RAY, an amount of US$ 78.86 million was approved by the GoI for 7 projects. During 2015-16, around 304 dwelling units under RAY were fulfilled. Moreover, work on providing the slums with basic amenities is under process along with the 1,050 dwelling units in the state. The state government has provided an impetus and would continue to strengthen the financial status of urban local bodies and provide adequate funds for improving civic amenities in urban areas. There are 77 urban local bodies in the state, consisting of nine municipal corporations, 19 municipal councils and 50 municipal committees. On the occasion of Golden Jubilee, in November 2016, the Central Government launched Deen Dayal Jan Awas Yojana scheme in the state. The scheme aims to put a check on the development of unauthorized colonies and simultaneously achieve the target of housing for all by 2022. The state has set the target to become ‘Kerosene Free’ by March, 2017. As of November 2016, 45 per cent BPL families were provided with LPG connections under the Pradhan Mantri Ujjawala Yojna (PMUY) scheme. Chinese company ‘Wanda,’ plans to invest US$ 8.96 billion for strengthening infrastructure facilities in the state of Haryana, by 2020. Realty firm, Signature Global, signed an agreement with the Government of Haryana in January 2017, for investing US$76.92 million to develop two housing projects in Gurgaon.
  • 26.
    2626MARCH 2017 Name ofproject Sector Project cost (US$ million) Stage Road upgradation (Punjab/Haryana Border-Jind) Project Roads & bridges 77.95 Under construction Construction of Kundli Manesar Palwal Expressway Roads and bridges 388.97 Under construction Amusement park at Gurgaon Social & commercial infrastructure 15.28 Under construction Construction of 4 laned ROB including its approach on Delhi Agra Railway Line near Bata Chowk Roads and bridges 3.67 Operational Unitech SEZ at Kundli, Sonipat Social & commercial infrastructure 3,362.37 Under construction Installation of 100 Reverse Osmosis Plants in 100 villages Water treatment plants 1.72 Under construction Development of Industrial Park, Gurgaon Social & commercial infrastructure 9.17 Operational Hotel Management Institute (Badhkal) Education 6.11 Operational Source: Department of Economic Affairs, Government of India; TechSci Research For updated information, please visit www.ibef.org DEVELOPMENT PROJECTS: KEY PUBLIC-PRIVATE PARTNERSHIP (PPP) PROJECTS … (1/2) HARYANA THE BREAD BASKET OF INDIA
  • 27.

    2727MARCH 2017 S No Someof the promoters of SEZs: Planned or under construction 1 Perpetual Infracon Pvt Ltd at Faridabad 2 Pioneer Urban Land and Infrastructure Limited 3 G.P. Realtors Private Limited 4 Ansal Colours Engineering SEZ at District Sonipat 5 DS Realtors Private Limited 6 Natasha Housing & Urban Development Ltd at Panipat 7 Orient Craft Infrastructure Limited 8 DLF Ltd. As of July 2016, the state had 7 operational SEZs, 23 formally approved SEZs, 3 SEZs with principal approval & 20 notified SEZs. 25 proposals have been granted in-principle/formal approval in the state by the Government of India. The state granted industrial colony licences to SEZs. Under the policy, 15% of land can be developed as residential area, 45% for industrial units and 5% for commercial use. The remaining 35% will be left for roads, infrastructure services and public utilities, apart from open spaces. In order to increase job opportunities in rural areas and set up industries, the Government of Haryana identified 32 blocks in the rural areas of Haryana for industrial development. For updated information, please visit www.ibef.org DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (1/5) HARYANA THE BREAD BASKET OF INDIA Source: Ministry of Commerce & Industry, Government of India,
  • 28.
    2828MARCH 2017 Source: Governmentof Haryana For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (2/5) The state government has approved, in principle, the setting up of an SEZ near Garhi Harsaru in Gurgaon district. The Garhi Harsaru SEZ would be utilised only for industrial purposes and cost US$ 341.74 million. The SEZ aims to promote FDI and resultant exports. The focus is on providing a hassle-free environment for export-oriented production. The proposed SEZ would be a duty-free enclave & a deemed foreign territory, where no licence would be required for imports. The import of capital goods, raw materials and consumables as well as their procurement from the domestic market to the SEZ would be exempted from customs duty and central excise duty. The supplies from domestic tariff area (DTA) to SEZ units would be treated as deemed exports. Through the automatic route, 100% FDI in the manufacturing sector would be allowed for projects set up in the SEZ. The SEZ units would be provided in-house customs clearance, and no separate documentation would be required for customs and Exim Policy.
  • 29.
    2929MARCH 2017 Source: Ministryof Commerce & Industry For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (3/5) IT/ITeS • DLF Cyber City • DLF Ltd • Gurgaon Infospace Ltd • Unitech Reality Projects Ltd. • ASF Insignia SEZ Pvt. Ltd. IT/ITeS • Selecto Systems Pvt Ltd • Perpetual Infracon Pvt Ltd IT/ITeS • Anant Raj Industries Ltd IT/ITeS Mittal Infratech Private Ltd. Index Operational SEZ Notified SEZ Punjab IT/ITeS • Anant Raj Industries Ltd.

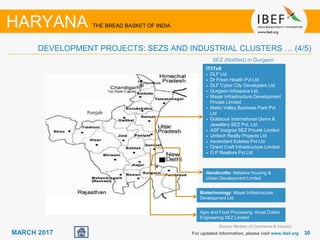

  • 30.
    3030MARCH 2017 Source: Ministryof Commerce & Industry For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (4/5) IT/ITeS • DLF Ltd. • Dr Fresh Health Pvt Ltd • DLF Cyber City Developers Ltd • Gurgaon Infospace Ltd. • Mayar Infrastructure Development Private Limited • Metro Valley Business Park Pvt Ltd • Goldsouk International Gems & Jewellery SEZ Pvt. Ltd. • ASF Insignia SEZ Private Limited • Unitech Realty Projects Ltd • Ascendant Estates Pvt Ltd • Orient Craft Infrastructure Limited • G P Realtors Pvt Ltd Handicrafts: Natasha Housing & Urban Development Limited Agro and Food Processing: Ansal Colors Engineering SEZ Limited Biotechnology: Mayar Infrastructure Development Ltd SEZ (Notified) in Gurgaon Punjab
  • 31.
    3131MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DEVELOPMENT PROJECTS: SEZS AND INDUSTRIAL CLUSTERS … (5/5) Index Textiles and handlooms Automotive Engineering IT and ITeS Petrochemicals Agro-based industry Industry clusters in Haryana Punjab
  • 32.
    3232MARCH 2017 Forupdated information, please visit www.ibef.org Source: Department of Information Technology, Government of Haryana GURUGRAM WORLD BPO HUB The Gurugram district is divided into 3 sub-divisions: Gurugram North, Gurugram South and Pataudi, which are further divided into 5 tehsils, namely, Gurugram, Sohna, Pataudi, Farukh Nagar, Manesar. Gurugram city, also known as a World BPO hub, serving industries like IT & ITES, Pharmaceuticals , FMCG etc., has provided direct and indirect employment to over 10 lakh people. IT and ESDM sector has proven to be the epicenter of city’s economic growth. Gurugram has a base of more than 450 companies employing 4,000 expats. Real estate is a major contributor in the city’s economy. Retail is an important sector in Gurugram, with 26 operational shopping malls. Gurugram Development Authority was founded in the year 2016, and covers a total area of 1,258 km2. In collaboration with NASSCOM, Gurugram is planning to set up a warehouse incubation centre of excellence cum innovation campus in hub and spoke model with an investment of US$ 0.61 million and operational expenditure of US$ 0.15 million, for a duration of 3 years. ECONOMIC SNAPSHOT Fact File of Gurugram Global BPM workforce 5% Country BPM Workforce 13% Contribution to State’s GDP 10% Contribution to Haryana’s Exports 54% 1,244.70 4,053.64 6,817.98 580.08 1,029.71 1,624.78 2004-05 2008-09 2011-12 Gurgaon Haryana Per-capita income (at current prices), US$ Source: Haryana Government Press Release
  • 33.
    3333MARCH 2017 Literacy rate(%) (2015-16) Total 75.55 Male 84.06 Female 65.94 The state has a strong primary education infrastructure, with a primary school located within a 1.03-km radius of each village & a middle school within a 1.07-km radius. As of 2015, there was 1 higher secondary & 1 senior secondary school within a 1.52-km & 2.28-km radius, respectively. In the 2016-17 budget, US$ 1.99 billion has been allocated for improving the education sector. For provision of funds to universities, the state government launched a centrally sponsored scheme, Rashtriya Uchchatar Shiksha Abhiyan (RUSA), for which US$ 25.35 million has been allocated during 2016-17. During 2015-16, the state witnessed the initiation of five new government colleges. Further, the state government also passed a bill for setting up the PDM University at Bahadurgarh during 2015-16. Moreover, an allocation of US$ 251.98 million and US$ 139.81 million has also been proposed by the state government for higher education and technical education, respectively, during 2016-17. The major flagship programmes being undertaken in the state include Rashtriya Madhyamik Shiksha Abhiyan (RMSA) and Sarv Shiksha Abhiyan (SSA). Other programmes for the upgradation of education sector in the state include Beti Bachao Beti Padhao (B3P), Haryana Ek Khoj under SSA, etc. For RMSA, SSA and Dual Desk Scheme, the state government has allotted investments of US$ 82.18 million, US$ 120.07 million and US$ 32.73 million respectively. For updated information, please visit www.ibef.org SOCIAL INFRASTRUCTURE – EDUCATION HARYANA THE BREAD BASKET OF INDIA No of educational institutions (2015) Universities 27 Colleges 976 Medical colleges 7 Engineering colleges 2,393 MBA colleges 190 MCA colleges 51 Industrial Training Institutes (ITIs) 224 Primary schools 8,899 Middle schools 2,395 Higher & Senior Secondary schools 3,210 Source: Haryana at a Glance, Government of Haryana website, AICTE, National Health Portal, TechSci Research MBA: Master of Business Administration, MCA: Master of Computer Applications Source: Economic Survey of Haryana, 2015-16
  • 34.
    3434MARCH 2017 Source: AnnualBudget 2016-17, Sample Registration System (SRS) Bulletin 1September 2015, 2Per thousand persons, 3Per thousand live births Health indicators (2015-16) Birth rate 2 21.3 Death rate 2 6.3 Infant mortality rate 3 41 Life expectancy at birth (years) Male (2011-15) 68.9 Female (2011-15) 71.3 As of December 2015, Haryana had 152 community health centres, 591 primary health centres, 2,812 sub-centres, 23 sub district hospitals and 27 district hospitals. As of 2015, the state had 67 Employees State Insurance (ESI) dispensaries. In the 2016-17 annual budget, US$ 598.37 million was allocated for health services, including medical education & family welfare. During 2015-16, work on construction of Kalpana Chawla Medical College at Karnal was under process. The college is being set up at a total cost of US$ 98.65 million. As per the state budget 2016-17, the state government is planning to establish new institutes and medical colleges in the state during 2016-17, which include Health University in Kutail district of Karnal, a new AIIMS (All India Institute of Medical Sciences) in Manethi village, a National Cardiovascular Institute at Badhsa village, as well as the medical colleges in Jind, Pinjore and Bhiwani. Further, the state government has also decided to set up an AYUSH University as well as AYUSH Cell across every PHC of the state. The health infrastructure of the state during 2015-16 includes 458 Ayurvedic dispensaries, 3 Ayurvedic hospitals, 6 Ayurvedic Prathmic Swasthya Kendras, 1 Unani Hospital, 18 Unani Dispensaries, 1 Institute of Indian Systems of Medicine & Research & 20 Homoeopathic Dispensaries. The state government is planning to make dialysis a more affordable & accessible medical procedure for people by increasing the number of dialysis centres in the state to 10 centres from the existing 4 centres. For updated information, please visit www.ibef.org SOCIAL INFRASTRUCTURE – HEALTH HARYANA THE BREAD BASKET OF INDIA Allocation, release and utilization under NHRM (US$ million) 47.98 52.02 52.66 41.36 49.48 52.41 45.39 32.82 61.32 70.30 72.69 2012-13 2013-14 2014-15 2015-16¹ Allocation Release Expenditure
  • 35.
    3535MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA CULTURAL INFRASTRUCTURE Phag, Dhamal, Ratvai, Khoria, Ghoomar & Ganguar are some of the many dance forms of Haryana. Important festivals of the state are Lohri, Basant Panchami, Holi, Gangore, Baisakhi, Nirjala Akadashi, Gugga Naumi & Navratri. Fairs held in Haryana include Gopal- Mochan, Masani, Basdoda, Surajkund and the Kartik Cultural Festival. Under Rajiv Gandhi Khel Abhiyan (RGKA), a block level stadium worth US$ 0.27 million would be constructed in the state. The outfield of this stadium, worth US$ 0.13 million, would be built under Mahatma Gandhi National Rural Employment Guarantee Act (MGNREGA). During 2015-16, various youth activities & programmes were organised by the state government for boosting the sports sector in the state. Further, the state is also deploying the “Haryana Sport & Physical Fitness Policy 2015”, under which the cash awards amounting to US$ 7.73 million & US$ 0.35 million have been circulated among 89 medal winners of Asian Games & 71 International medal winners. Moreover, the state government has allocated an amount of US$ 44.84 million for the sports sector during 2016-17. ‘Kingdom of Dreams’, which is India’s 1st live entertainment & leisure destination, is located in Gurgaon. The Epicentre in Gurgaon has been developed as an arts & culture centre. Some renowned museums in the state include Urusvati Museum of Folklore, Sanskriti Museum, Museum of Folk & Tribal Art in Gurgaon, Sri Krishna Museum (Kurukshetra) & City Museum (Chandigarh). In the 2016-17 budget, Kurukshetra was recognised under Krishna Circuit by the state government for the enhancement of tourism in the state. In addition to this, other 5 sites which have been recognized & qualified include Brahma Sarovar, Narkatari, Jyotisar, Amin Kund & Sannihit Sarovar. For the tourism sector, the state government has allocated US$ 10.2 million during 2016-17. Prominent stadiums in the state include Tejli Sports Complex (Yamunanagar), Nahar Singh Stadium (Faridabad), Tau Devi Lal Stadium (Panchkula) & Nehru Stadium (Gurgaon). In 2015-16, in order to improve the sports infrastructure, the Supplies & Disposal Department of Haryana purchased sports equipment worth US$ 0.15 million under the SC component scheme. Also, for the upgradation of yoga, it has been declared by the state government that yoga vayayamshalas will be established in across 6,500 villages of the state. Approval of the recruitment of 7 coaches & 1,000 instructors for yoga by the state government have been achieved during 2015-16. On the occasion of Golden Jubliee of the state of Haryana, on November 2nd , 2016, India’s Prime Minister launched 3 schemes for the state of Haryana - Deen Dayal Jan Awas Yojana, Automation of Fair Price Shops & Kerosene Free Haryana As of February 2017, the state government is planning to organize Surajkund International Crafts Mela twice in a year. Sri Lanka will also be considered as a partner country for the next edition of the Mela. Source: Economic Survey 2015-16, State Budget 2016-17
  • 36.
    3636MARCH 2017 • IndustrialModel Townships (IMT) – Developed and under developed • IMT Rohtak • IMT Faridabad • IMT Kharkhoda • IMT Mewat • IMT Bawal • IMT Manesar Historically an agrarian state, Haryana today is a well- developed industrial state. HSIIDC is the state’s premier industrial promotion agency. It is responsible for providing reliable and efficient facilities to entrepreneurs investing in the state. The state has taken several initiatives for developing industrial infrastructure to achieve consistent economic growth. HSIIDC has developed a number of industrial estates, industrial model townships and specialised parks for cluster development. Various industrial clusters that have come up across the state include footwear and accessories in Bahadurgarh, agricultural implements in Karnal, scientific instruments cluster in Ambala, handloom, hosiery and textile goods in Barhi, and fabrication & fitting cluster in Faridabad. An Industrial Model Township is located in Manesar, on NH- 8. The IMT deals in housing readymade garments, automobile industries, etc. For updated information, please visit www.ibef.org INDUSTRIAL INFRASTRUCTURE HARYANA THE BREAD BASKET OF INDIA Source: HSIIDC National Investment and Manufacturing Zones are conceived as major integrated industrial townships, that provide manufacturing industries with a conducive environment. During 2015-16, Manesar-Bawal Investment Region of Haryana has been approved as NIMZ in the country, Maruti Suzuki announced its plans to invest US$584.61 million in its new R&D center in Rohtak, which is expected to be operational by 2019.
  • 37.
    3737MARCH 2017 Forupdated information, please visit www.ibef.org SMART CITIES In August 2015, 2 cities of Haryana were proposed to be developed as smart cities. As of May 2015, along with the selected smart cities, 20 cities of Haryana were selected for infrastructure development under the AMRUT scheme. As of July 2015, under the AMRUT scheme, a total fund of US$ 1.12 million was allocated to Haryana and advance payment of US$ 0.83 million has already been made. Source: Census 2011 & TechSci Research HARYANA THE BREAD BASKET OF INDIA Faridabad Karnal On the basis of scoring, top 20 cities were selected by the panel of experts, for funding in 2015-16 under Smart Cities Mission. In addition to these 20 cities, the panel of experts also listed 23 states which will be provided with a special fast-track for upgrading their proposals. These states will be eligible for funding during 2016-17. With a score of 47.86%, Faridabad city of Haryana is also in the list. Gurgaon Smart cities in Haryana Cities Population Area (sq. km) Literacy rate Faridabad 1,809,733 741 81.70% Karnal 1,505,324 1,967 74.73%
  • 38.
    3838MARCH 2017 Estate/location Briefdescription IMT Manesar (Phase I is complete, Phases II, III, IV and V are undergoing development) • Located at a distance of 50 km from Delhi on NH-8 & about 32 km from the IGI Airport. • Focus on hi-tech and hi-precision non-polluting units such as automotive, readymade garments, ITeS and packaging. IIDC, Saha (Status- Planned & Developed) • Located on NH-10, about 250 km from New Delhi. • HSIIDC acquired around 76 acres of land for setting up IIDC in Saha. Udyog Vihar, Gurgaon • Located on NH-8, about 8 km from IGI. • Focus on IT/ITeS, electronics, electrical goods, pharmaceuticals, light engineering, auto parts and components and readymade garment sectors. • Maruti Udyog, a leading car manufacturer of India, has its base in Udyog Vihar. Kundli Phases I, II, IV, EPIP and Electronic Hardware Technology Park (Status - Planned & Developed) • Located on NH-1 on the Delhi-Haryana border, about 20 km from Delhi. • Has industrial units from general engineering, cycle parts, dairy products & agro-based sectors. Faridabad • Located about 35 km from New Delhi, on the Delhi-Mathura highway. • Has industrial units for the light engineering sector. Murthal • Located about 50 km from New Delhi, on NH-1. • Has industrial units from general engineering, malt, chemicals & cycle parts sectors. Panipat (Status - Fully Developed) • Located about 89 km from New Delhi, on NH-1. • It covers 922 acres of area and is a well-equipped facility with an internal road network & electric distribution system. For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA INDUSTRIAL INFRASTRUCTURE – EXISTING INDUSTRIAL ESTATES … (1/2) Source: HSIIDC website
  • 39.
    3939MARCH 2017 Estate/location Briefdescription Ambala • Located about 200 km from New Delhi, on NH-1. • Has industrial units from scientific instruments, electronic and light engineering sectors. • It also has a United Nations Development Programme (UNDP) assisted instrument design and development centre. Tohana (Status- Planned & Developed) • Located about 200 km from New Delhi. • Has industrial units from agriculture implements, foundry and light engineering sectors. Jind • Located about 120 km from New Delhi. • Has agro-based industries, leather based products and chemical industries Samalkha (Status- Planned & Developed) • Located about 70 km from New Delhi on NH-1 • Has light engineering and foundry units. Rai (Status- Planned & Developed) • Located about 35 km from New Delhi on NH-1. • A food park and a technology park have been developed here. Barwala (Phase-l Completed and Phase-ll under-construction) • Located at about 240 km from New Delhi, Panchkula-Saha State Highway, in District Panchkula • Has industrial units of plywood, pharmaceuticals units and light engineering works. Other industrial estates under implementation are ancillary estates at Panchkula, Kalka, Murthal, integrated infrastructure development centre at Sirsa, built-up sheds near Sohna, and estates at Manakpur in Yamuna Nagar. For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA INDUSTRIAL INFRASTRUCTURE – EXISTING INDUSTRIAL ESTATES … (2/2) Source: HSIIDC website
  • 40.
    4040MARCH 2017 Estate/location Briefdescription Barhi (Status- Planned & Developed) • Located about 57 km from Delhi on NH-1, near Gannaur in Sonepat District. • List of key industrial units include Seasons Textiles, Wooltex Textiles, Kaico Deer, EOC Polymer, etc. Bahadurgarh (Sector 18 & 18A) • Just next to New Delhi on NH-10 linking Delhi with Rohtak and Hissar in District Jhajjar. • HSIIDC acquired around 138 acres of land for setting up an industrial estate in Bahadurgarh (Jhajjar district). Growth Centre, Saha (Phase-l is completely planned and developed; Phase-ll is planned and under- construction) • Located about 180 km from Delhi on NH-73 and is about 15 km from Ambala Cantt • Key companies include Mount Shivalik Breweries Ltd, Super Filtration System Ltd, Osaw Agro Industries Ltd, Kandhari Beverages (P) Ltd and Mahaunt Agro (P) Ltd Hosiery complex in Barhi (expansion in planning stage) • A hosiery and textile park exists in Barhi near Ganaur, in Sonipat district, and an industrial complex is being planned as part of the expansion. Three more townships are being planned at Sampla, Badli-Jahangirpur and Ganaur-Samalkha. For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (1/3) Source: HSIIDC website
  • 41.
    4141MARCH 2017 Forupdated information, please visit www.ibef.org INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (2/3) Kundli-Manesar-Palwal (KMP) expressway: The government is developing sector specific theme parks and sub-cities along the KMP expressway. The 135-km KMP expressway will act as a Delhi bypass and provide seamless connectivity across NH-1, NH-2, NH-8 and NH-10. Total cost of the project is US$ 414.73 million. In addition to industrial infrastructure, the project aims to provide smooth and quick transportation of surplus food grains, milk products, fruits and vegetables from Haryana, Punjab, Himachal Pradesh and Kashmir to other parts of the country. Source: HSIIDC website Mega-projects of Haryana Kundli-Manesar-Palwal (KMP) Expressway on Build-Operate- Transfer (BOT) basis Delhi-Mumbai Industrial Corridor (DMIC) Project Manesar Bawal Investment Region (MBIR) Early Bird Projects (Global City Project, Integrated Multimodal Logistics Hub (IMLH), Mass Rapid Transit System Between Gurgaon-Manesar-Bawal (MRTS) HARYANA THE BREAD BASKET OF INDIA Delhi-Mumbai Industrial Corridor (DMIC) Project: The 1,500-km Delhi-Mumbai Industrial Corridor (DMIC) project worth US$ 90 billion will serve as a dedicated freight corridor between Delhi and Mumbai. The project plans to create self sustaining industrial townships within the corridor. These townships would be served by multi-modal connectivity for freight movement as well as reliable power and air connectivity. The project incorporates Nine Mega Industrial zones of about 200–250 sq km area, high-speed freight line, three ports and six airports; a six-lane intersection-free expressway connecting the country’s political and financial capitals and a 4,000-MW power plant. The corridor is expected to create 2.5 million new jobs. The DMIC covers nearly 14 districts of Haryana – 66% of the state’s total area. International Cargo Airport at Bhaini Maharajpur & Bhaini Bhairon villages is a greenfield project located at the tri- junction of Rohtak, Hisar and Bhiwani districts. The proposed airport would be about 110 km from New Delhi’s IGI Airport.
  • 42.
    4242MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA INDUSTRIAL INFRASTRUCTURE – UPCOMING INDUSTRIAL ESTATES … (3/3) Manesar Bawal Investment Region (MBIR): The 800 square km Manesar Bawal Investment Region (MBIR) would provide investment opportunities alongside NH-1, NH- 2, NH-8 & NH-10. With this, the government aims at developing urban, industrial and economic infrastructure in the state. The planned residential population of MBIR is 3.20 million, employment potential of 1.6 million and industrial output value of US$ 50 billion. During 2015-16, the master plan notification for the region has been completed and Ministry of Environment, Forest and Climate Change (MoEFCC) has also obtained the environmental clearance for the region. Moreover, the plan for integrated water resources management for the region has also been decided. Early Bird Projects: Global City Project: This 1,100 acres project located in Gurgaon is expected to be the biggest facility in the country. This project would cater to the hospitality sector and meet the business needs of the corporates and public enterprises. Integrated Multimodal Logistics Hub (IMLH): The 900 acres project located in district Rewari is worth US$ 500 million. This project is expected to be the union point for cargo movement from Punjab, NCR, Haryana and Rajasthan. Mass Rapid Transit System Between Gurgaon-Manesar-Bawal (MRTS): The 130 km MRTS aims to provide connectivity between Gurgaon, Manesar, Dharuhera and Bawal. This includes connection of 57 stations with Delhi Metro and is expected to carry 1.16-2.24 million passengers per day by 2040. Source: HSIIDC website

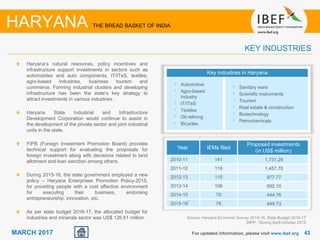

  • 43.
    4343MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES Haryana’s natural resources, policy incentives and infrastructure support investments in sectors such as automobiles and auto components, IT/ITeS, textiles, agro-based industries, business tourism and commerce. Forming industrial clusters and developing infrastructure has been the state’s key strategy to attract investments in various industries. Haryana State Industrial and Infrastructure Development Corporation would continue to assist in the development of the private sector and joint industrial units in the state. FIPB (Foreign Investment Promotion Board) provides technical support for evaluating the proposals for foreign investment along with decisions related to land allotment and loan sanction among others. During 2015-16, the state government employed a new policy – Haryana Enterprises Promotion Policy-2015, for providing people with a cost effective environment for executing their business, endorsing entrepreneurship, innovation, etc. As per state budget 2016-17, the allocated budget for industries and minerals sector was US$ 126.61 million. Source: Haryana Economic Survey 2015-16, State Budget 2016-17 DIPP, 1During April-October 2015 Key industries in Haryana • Automotive • Agro-based industry • IT/ITeS • Textiles • Oil refining • Bicycles • Sanitary ware • Scientific instruments • Tourism • Real estate & construction • Biotechnology • Petrochemicals Year IEMs filed Proposed investments (in US$ million) 2010-11 141 1,731.25 2011-12 118 1,457.70 2012-13 115 977.77 2013-14 106 692.10 2014-15 70 444.76 2015-16 1 76 449.73
  • 44.
    4444MARCH 2017 Haryana isa preferred destination for auto majors and auto- component manufacturers. The state is host to many large automotive players. The state produces two-thirds of passenger cars, 50% of tractors, 60% of motorcycles and 50% of the refrigerators manufactured in the country. A significant percentage of the state’s workforce is engaged in the automotive industry; Gurgaon & Faridabad are important automobile centres. The International Centre for Automotive Technology (ICAT) has been set up at Manesar as a part of the National Automotive Testing & Research & Development (R&D) Infrastructure Project (NATRiP). It provides testing & R&D services to the industry. In March 2016, Honda Motorcycle & Scooter India Pvt. Ltd. launched its CD 110 Dream Deluxe with self start feature in Manesar. The state government has proposed a sliding railway & logistics centre in IMT Manesar for smoother transportation & more effective inventory management. For updated information, please visit www.ibef.org KEY INDUSTRIES – AUTOMOTIVE INDUSTRY … (1/2) HARYANA THE BREAD BASKET OF INDIA Some of the key players • Maruti Suzuki India Ltd • Yamaha Motor Pvt Ltd • Escorts Group • General Motors India Pvt Ltd Source: Haryana Economic Survey, 2015-16
  • 45.
    4545MARCH 2017 Maruti SuzukiIndia Ltd General Motors India Pvt Ltd Escorts Group Yamaha Motor Pvt Ltd For updated information, please visit www.ibef.org • Maruti Suzuki India had a market share of around 40 cent in the Indian passenger car market at the end of March 2012. Its Gurgaon facility has three integrated plants, with an installed capacity of around 900,000 units; the fourth plant is located at Manesar. In 2012-13, US$ 354 million was invested in the Manesar plant. The Gurgaon plant would eventually serve as a base for engine assembly and machining, while automobile assembly is done at the Manesar plant. The company recorded revenues of US$ 8.60 billion in 2015-16. • General Motors India Pvt Ltd, founded in 1996, is a wholly owned subsidiary of General Motors and is engaged in the automobile business in India. Its subsidiary Chevrolet Sales India Pvt Ltd is headquartered in Gurgaon. As of December 2014, the company employs around 216,000 persons in 158 facilities globally. • Escorts is a leading engineering conglomerate in the high growth sectors of agri-machinery, construction and material handling equipment, railway equipment and auto components. Its corporate headquarters and manufacturing facilities for tractor assembly, transmission and engines, crankshaft and hydraulics is located in Faridabad. The company posted revenues of US$ 540.42 million during 2015-16. • Yamaha Motors is a 100% subsidiary of Yamaha Motor Company Ltd, Japan. The company has more than 2,000 employees in India, and a countrywide network of over 400 dealers. It has a manufacturing plant in Faridabad, which supplies bikes to the domestic as well as overseas market. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – AUTOMOTIVE INDUSTRY … (2/2)
  • 46.
    4646MARCH 2017 Gurgaon hasemerged as a preferred destination for the IT industry in North India, with more than 400 IT & ITeS companies. The government has granted licenses to 50 proposals for establishment of IT/cyber projects as of August 2015. Haryana is among the leading states in terms of IT exports. As of September 2015, Gurgaon accounted for a share of around 9% in the overall software exports from the country. The state government has extended various incentives to companies within the sector, including relaxation in floor area ratio, rebate on registration, transfer of property charges & exemption under the Haryana Shop & Commercial Act. Haryana is the 1st state to have implemented its State Wide Area Network (SWAN) for voice, data & video transmission. The SWAN vertical connectivity – at the State Network Management Centre (SNMC), District Network Management Centre (DNMC) & Block Network Management Centre (BNMC) – is completed & now operational. As of March 2017, the state is strengthening its digital infrastructure by ensuring rolling out of National Optic Fibre Network to 4,051 gram panchayats along with providing Wi-fi to 119 gram panchayats. For updated information, please visit www.ibef.org KEY INDUSTRIES – IT/ITES INDUSTRY … (1/2) HARYANA THE BREAD BASKET OF INDIA Some of the key players • IBM Global Process Services • Tata Consultancy Services (TCS) • Microsoft Corporation (I) Pvt Ltd • Google In the 2016-17 state budget, the Department of Electronics & IT was allocated a proposed outlay of US$ 12.98 million. As per Economic Survey 2015-16, in order to fulfil the vision of digital empowerment of the citizens, the government is targeting to provide training to around 50 lakh citizens in the coming 5 years, of which 10 lakh citizens are to be trained during 2016-17. The total amount of US$ 15.27 million has been proposed by the state government for this purpose. Haryana Knowledge Corporation Ltd. HKCL) has set up 205 official learning centres. The state government is targeting in adding 500 more such centres in the state during 2016- 17. Source: Haryana Economic Survey, 2015-16, State Budget 2016-17
  • 47.
    4747MARCH 2017 IBM GlobalProcess Services Tata Consultancy Services (TCS) Microsoft Corporation (I) Pvt Ltd Google For updated information, please visit www.ibef.org • IBM Global Process Services (formerly IBM Daksh) is a leading provider of business process solutions, with its corporate office in Gurgaon. The company has 23 service delivery centres at nine locations in India and Philippines and employs more than 100,000 persons, making it one of the largest Business Process Outsourcing (BPO) vendors in India in terms of headcount. Haryana was awarded the software centre of excellence by IBM. • TCS is among the largest providers of IT and BPO services in India. The company’s clients are in BFSI, healthcare & life sciences, insurance, manufacturing, media, entertainment, transportation, travel & hospitality, retail, utilities and energy resources sectors. It commenced operations in Gurgaon in 1995. The company posted revenues of US$ 16.59 billion in 2015-16. • Microsoft entered India in 1990 and works closely with the Indian government, IT industry, academia and the local developer community. Microsoft has offices in 10 cities: Ahmedabad, Bengaluru, Gurgaon, Chennai, Hyderabad, Kochi, Kolkata, Mumbai, New Delhi and Pune. • In India, Microsoft employs about 5,800 people and has six business units representing the complete Microsoft product lifecycle. The company has two offices in Haryana, both at Gurgaon. • Google, a web based search engine, is the flagship product owned by Google, Inc. It offers special features such as synonyms, weather forecasts, time zones, stock quotes, maps, earthquake data, movie-show times, airports, home listings and sports scores. • Google has a sales office in Gurgaon. It is a direct sales organisation and helps the world's biggest advertisers to enjoy immediate and accountable communication with the consumer. The sales teams here are structured according to industry verticals. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – IT/ITES INDUSTRY … (2/2)
  • 48.
    4848MARCH 2017 Agriculture isone of the biggest employment generators in rural Haryana, with strong potential in value addition & exports. Haryana is self-sufficient in food production & the 2nd-largest contributor of food grains to the central pool. The Department of Horticulture encourages a cluster approach for the development of fruit cultivation. A horticulture terminal market, being developed at Ganaur, would act as an export hub for fruits, flowers & vegetables from all over the country. Haryana aggressively promotes organic farming; financial assistance is provided to farmers for production and use of vermicompost. The state government approved US$ 9.48 million for minor irrigation systems till January 2016. Furthermore, under National Mission on Micro Irrigation scheme, the state government has set a target to cover over 9,588 hectares of area for horticulture crops. In January 2016, Haryana State Flood Control Board sanctioned US$ 19.06 million for 105 new schemes and US$ 39.23 million for 140 ongoing schemes for flood control and improving the drainage works. In February 2017, the state government decided to constitute a committee of Council of Ministers for preparing a blueprint of integrated Dairy Complexes in all cities of the state. For updated information, please visit www.ibef.org KEY INDUSTRIES – AGRO-BASED INDUSTRY … (1/3) HARYANA THE BREAD BASKET OF INDIA In 2015-16, production of fruits and vegetables in the state, stood at 384.06 thousand tonnes and 3,547.17 thousand tonnes, respectively. During 2015-16, till December 2015, the state accounted for an area of 380.91 thousand hectares for horticulture crops. The total production of horticulture crops in 2015-16 was 4,033.61 thousand metric tonnes Source: Economic Survey of Haryana, 2015-16 Production of horticulture crops in Haryana (‘000 MT.) Crop 2014-15 2015-16 Total fruits 703.67 384.06 Total vegetables 5,285.55 3,547.17 Total spices 81.19 62.44 Total flowers 62.86 38.86
  • 49.
    4949MARCH 2017 During 2015-16,under MIDH (Mission for Integrated Development of Horticulture) US$ 11.86 million was allocated for the state, of which US$ 5.93 million has been released. This mission is undertaken by the state government for holistic development of horticulture sector, in which a 50:50 contribution would be done by Government of India and state governments. Under National Horticulture Mission, US$ 10.92 million was allocated for the state and US$ 5.46 million was released, during 2015-16. Spices production in the state stood at 62.44 thousand MT by the end of December 2015. According to Haryana Renewable Energy Development Agency (HAREDA), Germany based Verbio AG, has approached the Haryana government to invest US$ 15 million to develop bio-CNG, from paddy residue in the state. For updated information, please visit www.ibef.org KEY INDUSTRIES – AGRO-BASED INDUSTRY … (2/3) HARYANA THE BREAD BASKET OF INDIA Source: National Horticulture Board Haryana total area under cultivation for horticulture crops (‘000 Ha) Haryana total production for horticulture crops (‘000 MT) Source: Economic Survey of Haryana, 2015-16 Note: 2015-16(1) :Till December 2015 434.2 448 440 457 2012-13 2013-14 2014-15 2015-16 5676.1 6,286 6,819 6,337 2012-13 2013-14 2014-15 2015-16
  • 50.
    5050MARCH 2017 Nestle IndiaLtd GlaxoSmithKline Consumer Healthcare Ltd (GSK) Haldiram’s Foods International Ltd PepsiCo India For updated information, please visit www.ibef.org • Nestle India is a subsidiary of Nestle SA, Switzerland. Its Indian headquarter is in Gurgaon, Haryana. Its famous brands in India include Nescafé, Maggi, Milkybar, Milo, Kit Kat, Bar-One, Milkmaid, Nestea, Nestle Milk, Nestle Fresh 'n' Natural Dahi and Nestle Jeera Raita. The company has a factory at Samalkha, Panipat, which was commissioned in 1993, to manufacture milk products. The company recorded revenues of US$ 351.74 million during the first quarter of 2016. • GlaxoSmithKline Consumer Healthcare Ltd (GSKCH) is an Indian group company/associate of GlaxoSmithKline UK and one of the largest players in the health food & drink industry in India. GSK has a factory at village Khewra, Sonipat, with a capacity of 26,100 tonnes per annum for its brand Horlicks. In 2015-16, the revenues recorded by the company stood at US$ 658.22 million. • Haldiram's started in Bikaner and is one of India's largest sweets and snacks manufacturers. The company sells packaged food and snacks, which are not only consumed in domestic markets but also exported to various countries viz., Pakistan, Canada, Australia, Sri Lanka, Singapore, Malaysia, South Africa, Indonesia, Qatar, Hong Kong, Japan, Kenya, Libya and South Korea. Haldiram’s also has its own outlets where it sells sweets and eatables. In Haryana, Haldiram Manufacturing Co Pvt Ltd is located in village Kherki Daula on the Delhi-Jaipur highway. • PepsiCo established its business operations in India in 1989. The company has a diverse range of products including carbonated drinks and potato chips. It employs 6,400 people and provides indirect employment to almost 200,000 people. It has 38 beverage bottling plants and three food plants in the country. Its corporate office is in Gurgaon. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – AGRO-BASED INDUSTRY … (3/3)
  • 51.
    5151MARCH 2017 Abundant availabilityof raw materials gives Haryana a competitive advantage in the textile sector – cotton production in 2015-16 was around 2.6 million bales (bales of 170 kg each). The average yield and area in 2015-16 was around 700 kg per hectare and 650 thousand hectares, respectively. Readymade garments worth around US$ 1.3 billion are exported from Haryana annually, providing employment to around one million workers. A cluster of high-fashion readymade garment units has come up in the well-developed industrial area of Udyog Vihar, Gurgaon. Panipat, known as the “city of weavers”, has established itself as a centre for handloom products on the global map. In the 12th Five Year Plan, the Ministry of Textiles, Government of India, launched the ISDS (Integrated Skill Development Scheme). The aim of this scheme is to train 15 lakh people for skill development. The state of Haryana aims at training around 20,000 people under this project at an estimated cost of US$ 3.31 million. The total training cost would be split in the ratio of 75:25 between the Government of India and the state government. For updated information, please visit www.ibef.org KEY INDUSTRIES – TEXTILES … (1/3) HARYANA THE BREAD BASKET OF INDIA Source: Economic Survey of Haryana 2015-16, Ministry of Textiles Haryana total khadi production (US$ million) Haryana total khadi sales (US$ million) The handloom business is expected to receive a further boost with the establishment of the proposed International Trade and Convention Centre in Panipat. It will function as a design centre for the handloom products. 13.17 14.14 2013-14 2014-15 16.41 17.38 2013-14 2014-15
  • 52.
    5252MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – TEXTILES … (2/3) Source: Ministry of MSME Spun yarn production (2015-16 - up to September 2015) Production (‘000 kg) Share (%) 121,659 4.3 Cotton yarn production (‘000 kg) 2014-15 2015-16 214,159 54,859 Funds released under National Handloom Development Programme (2014-15) – US$ million Integrated Handloom Development Scheme (IHDS) 0.03 Handloom Marketing Assistance (HMA) 0.02 Diversified Handloom Development Scheme (DHDS) 2.13 Funds Released Under handicraft schemes (2015-16) – US$ thousand Ambedkar Hastshilp Vikas Yojna (AHVY) 86.77 Design and Technological Up-gradation 3.67 Human Resource Development Scheme 31.55 Total 121.98
  • 53.
    5353MARCH 2017 DCM Textiles BenettonIndia Pvt Ltd Orient Craft Ltd Pearl Global Ltd For updated information, please visit www.ibef.org • The company manufactures 100% grey cotton yarn and melange yarn. It has a spinning mill located in Hisar, with an installed capacity of 74,436 spindles. The company exports to 25 countries, including Spain, Portugal, Egypt, South Korea, Brazil, Hong Kong, Italy and Israel. • Benetton India is a wholly owned subsidiary of the Benetton Group, Italy. United Colors of Benetton is among the market leaders in branded apparel, with around 480 stores across 100 cities. The company has a manufacturing unit in Gurgaon. • Orient is located in Gurgaon and employs around 5,000 people. It has established itself as a premium exporter of textiles from Haryana people. The company has the combined capacity to produce nearly 200,000 pieces per day at 21 units across the country. • Pearl Global Ltd is a subsidiary of House of Pearl Fashions Ltd Group, which is among the pioneers of the ready-to-wear apparel industry in India. • The company has six fully integrated manufacturing plants in Gurgaon, with a capacity for producing value added woven and knitted garments. The total factory area in north India covers more than 310,000 sq ft. The installed capacity on a single shift basis stands at 10 million pieces per annum. The units specialise in casual-wear dresses, ladies blouses in both woven and knits. Important customers of the company include Gap, Inc, JC Penney, Kohls, Next, H&M and Esprit. Revenue for the year ended March 2016 was US$ 212.87 million. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – TEXTILES … (3/3)
  • 54.
    5454MARCH 2017 Panipat Refinery,which is a unit of Indian Oil Corporation Limited (IOCL), was commissioned in 1998 and during 2015-16, the refinery had a capacity of 15.000 MMTPA . As per refinery operations data for FY2016, the refinery produces diesel and gasoline which are compliant to BS-IV specifications. For leveraging the establishment of a petrochemical plastic park and hub at Panipat under vicinity of IOCL, the “Enterprises Promotion Policy-2015” was launched by Government of India, which became effective in the state from August 2015. For updated information, please visit www.ibef.org KEY INDUSTRIES – PETROCHEMICALS … (1/2) HARYANA THE BREAD BASKET OF INDIA Consumption of major petroleum products during 2014-15 (‘000 tonnes) Petroleum products Haryana India Naphtha 3,259 10,938.7 Liquefied petroleum gas (LPG) 586 18,019 Motor spirit (MS) 724 19,075 Superior kerosene oil (SKO) 71 7,087 Aviation turbine fuel (ATF) 35 5,578 High speed diesel (HSD) 5,029 69,404 Light diesel oil (LDO) 4 365 Bitumen 203 4,983 Others 675 29,537.3 Total 10,586 164,987 Source: Ministry of Petroleum & Natural Gas
  • 55.
    5555MARCH 2017 Forupdated information, please visit www.ibef.org KEY INDUSTRIES – PETROCHEMICALS … (1/2) HARYANA THE BREAD BASKET OF INDIA • IOCL manufactures petroleum products, crude oil, lubricants, grease, oil base, additives etc. • IOCL has a refinery at Panipat, the company’s seventh. The refinery was set up in 1998 at a cost of US$ 848 million, with a capacity of 6 million metric tonnes per annum (MMTPA). The Panipat refinery has increased its refining capacity from 6 MMTA to 15 MMTA with the commissioning of its expansion project. • Kandla-Bhatinda product pipeline was converted to crude oil service and renamed as Mundra- Panipat pipeline in 2006. The Mundra-Panipat pipeline augmentation was commissioned in 2009 at a cost of US$ 34.80 million. • In March 2010, a naphtha cracker complex was set up adjacent to the Panipat refinery at an investment of US$ 3.04 billion. • The company recorded total revenues of US$ 54.37 billion for 2015-16. Indian Oil Corporation Ltd (IOCL)
  • 56.
    5656MARCH 2017 The realestate and construction industry has grown rapidly in Haryana. The growth in real estate in Haryana encompasses activities in the residential, commercial and hospitality space. Real Estate Development Council (REDCO) is the apex body for all stakeholders in the housing and construction industry; it was launched jointly by the Government of Haryana and the Ministry for Urban Development, Government of India. Gurgaon accounts for more than 70% of the new commercial space coming up in the NCR. Gurgaon is registering the fastest growth in the real estate sector in India. Owing to Gurgaon’s reputation as an IT hub and proximity to the national capital Delhi, demand for both housing and commercial space is rising. To accommodate further growth, the state has finalised the new Gurgaon-Manesar Master Plan-2025. The plan allocates land for developing residential and growth corridors. Adani realty team has tied up with US-based Brahma Management for a 150 acre township in Gurgaon. New Gurgaon is one of the top realty destinations, with its world-class infrastructure, amenities and connectivity with neighbouring states. Gurgaon-Sohna road is another big site for commercial as well as residential development. In June 2015, the central government launched the Atal Mission for Rejuvenation and Urban Transformation (AMRUT). Under this, 19 cities have been selected in the state, namely Ambala Urban Agglomeration, Hisar, Bahadurgarh, Ambala Municipal Corporation, Bhiwani, Gurgaon, Faridabad, Jind, Kaithal, Karnal, Palwal, Panipat, Panchkula, Rewari, Rohtak, Thanesar, Yamunanagar and Sonepat. For updated information, please visit www.ibef.org KEY INDUSTRIES – REAL ESTATE AND CONSTRUCTION … (1/2) HARYANA THE BREAD BASKET OF INDIA As per the 2016-17 budget of Haryana, the state government has proposed an allocation of US$ 22.91 million under the state’s scheme of “Housing for All”. Further, the state government also implemented Deen Dayal Jan Awas Yojana in the state for boosting the development of colonies plotted with high density. With the transparent and liberal New Integrated Licensing Policy in the state, the state government is aiming to provide houses to all the people at economical prices as per the budget 2016-17. The progress of clearances on Renuka and Kishau dams is in its advanced stage. With completion of these projects, the state is expected to get regular water supply from the Yamuna. Source: State budget 2015-16, economic survey 2015-16,
  • 57.
    5757MARCH 2017 DLF Ltd UnitechGroup Ansal Housing & Construction Ltd Emaar MGF Land Ltd For updated information, please visit www.ibef.org • DLF Group is one of the largest real estate players in India. Its primary business is development of residential, commercial and retail properties. DLF has been in the industry for over 60 years, having developed homes, offices, malls, SEZs, hotels and infrastructure projects. In 2015-16, the company garnered US$ 1.5 billion in revenues. • In August 2009, the foundation stone was laid for the first private metro rail project in the country. It is to be developed in Gurgaon by the DLF-IL&FS consortium. The 6.1-km rapid metro rail project has commenced trial runs and would be commercially operational in a few months. In November 2013, Phase-I got operational and Phase-ll is expected to get operational by the end of 2015. • Unitech is among the largest real estate players, which have executed projects in Gurgaon with world-class service facilities. Its projects include Nirvana Country, Unitech World, Unitech Trade Centre, Unitech Business Park, Millennium Plaza (jointly developed with Vipul), Signature Towers and Global Business Park (jointly developed with Vipul). • In 2015-16, the company registered revenues of US$ 306.68 million. • Ansal Group expanded its activities from real estate development to high-value construction. In 2015-16, the company posted revenues of US$ 68.51 million. • It is present in Gurgaon through several projects in both residential and commercial spaces. • The group presently employs over 5,000 persons. • Emaar MGF is a joint venture between Emaar Properties PJSC Dubai, a leading global real estate company, and MGF Development Ltd, one of the leading real estate developers. • The company has several housing and commercial projects in the state. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – REAL ESTATE AND CONSTRUCTION … (2/2)
  • 58.
    5858MARCH 2017 The Governmentof India selected Haryana for the establishment of a biotechnology park along with R&D facilities, besides promoting the establishment of a pharma industrial park. The state government acquired 1,000 acres of land for a dedicated pharma park in the KMP (Kundli- Manesar-Palwal) express global economic corridor. Establishment of research centres and laboratories in collaboration with the private sector is being encouraged. The state government has established a Regional Centre for Biotechnology (RCB), Gurgaon under the guidance of UNESCO as a Category II Centre. This centre was established for education, training, and research in biotechnology and undertakes contemporary research at the interface of various disciplines. The centre started functioning in its permanent campus in Faridabad, Haryana in January 2015. For updated information, please visit www.ibef.org KEY INDUSTRIES – BIOTECHNOLOGY … (1/2) HARYANA THE BREAD BASKET OF INDIA Key players • Proagro Seeds Company Pvt Ltd • Eli Lilly Company (India) Pvt Ltd • Sun Pharma • Venus Remedies Ltd During 2015-16, various science fairs and exhibitions took place in the state. Moreover, during 2015-16 (up to October 2015), a total of 24,815 INSPIRE awards were sanctioned to the state.
  • 59.
    5959MARCH 2017 Proagro Seeds CompanyPvt Ltd Eli Lilly and Company (I) Pvt Ltd Venus Remedies Ltd For updated information, please visit www.ibef.org • Proagro Seeds Company Pvt Ltd, a leading seed company in India, is a Bayer CropScience Group company. It is engaged in breeding, development, production and marketing of high quality hybrid field seeds. • The company has a biotech laboratory in Gurgaon where genetic markers, DNA finger printing and other testing techniques are used to support the company’s plant breeding efforts. • Eli Lilly and Company (India) Pvt Ltd is a subsidiary of the US pharmaceutical major Eli Lilly and Co. Its primary focus is on diabetes, oncology, acute coronary syndrome, critical care, osteoporosis and growth hormones, and employs more than 550 people across India. • In India, Eli Lilly operates in Gurgaon and conducts clinical trials of biotech drugs with its overall range. • Venus Remedies Ltd is among the 10 leading fixed-dosage injectable manufacturers worldwide. The company has presence in 60 countries and covers more than 75 products. The company registered revenues of US$ 63.90 million in 2015-16. • The company’s' first manufacturing unit commenced operations in 1991 in Panchkula, Haryana. It manufactures products in the categories of antibiotics, Total Parenteral Nutrition (TPN), neuro and other super-specialty therapeutic segments at its Panchkula unit. HARYANA THE BREAD BASKET OF INDIA KEY INDUSTRIES – BIOTECHNOLOGY … (2/2) Sun Pharmaceutical Industries Ltd • Sun Pharmaceutical Industries Ltd, one of India's largest pharmaceutical companies, is an integrated, research-based pharmaceutical company with a global presence. The company recorded revenues of US$ 4.31 billion in 2015-16. The company announced the acquisition of Ranbaxy Laboratories Limited in April 2014, and completed the acquisition deal in March 2015. The company manufactures a wide range of generic medicines in its 45 manufacturing sites across the globe. Sun Pharma Industries Ltd has two manufacturing facilities in Madhya Pradesh at Dewas and Malanpur.
  • 60.
    6060MARCH 2017 Single-window clearancemechanism was established under the Haryana Industrial Promotion Act, 2005. It has a three-tier structure to grant exemption/relaxation from any of the provisions/rules of the Act. The Investment Promotion Centres (IPC) located in New Delhi and Chandigarh and District Industries Centres (DIC) at the district level serve as nodal agencies and provide support to the committees. For updated information, please visit www.ibef.org SINGLE-WINDOW CLEARANCE MECHANISM HARYANA THE BREAD BASKET OF INDIA Investment handled Under the Chairmanship of Nodal agencies Greater than US$ 6.5 million US$ 1.09 to US$ 6.5 million Less than US$ 1.09 million High- Powered Clearance Committee State-Level Clearance Committee District-Level Clearance Committee Principal Secretary to Chief Minister Principal Secretary Industries Deputy Commissioner Investment Promotion Centre (IPC) – State Level District Industries Centre (DIC) – District Level
  • 61.
    6161MARCH 2017 Agency Description HaryanaState Industrial and Infrastructure Development Corporation Ltd (HSIIDC) • Focusses on the development of medium- and large-scale industries. • Provides financial assistance by way of term loans, equipment re-finance, equipment leasing and working capital. Haryana Agro Industries Corporation Ltd (HAIC) • Engaged in trading activities such as sale of seeds, fertilisers, pesticides, tractors and other agricultural machinery at economical prices to the farming community. Haryana State Electronics Development Corporation Ltd (HARTRON) • Nodal agency of the Government of Haryana for promoting electronics and IT industries. • It offers expertise in infrastructure development as well as promotion of projects. Haryana Urban Development Authority (HUDA) • Responsible for promoting and securing development of urban areas; activities include land acquisition, development and sale of property for residential, industrial and commercial purposes. Haryana Finance Corporation (HFC) • Meets the credit needs of small- and medium-scale industrial units by advancing term loans. For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA KEY INVESTMENT PROMOTION OFFICES
  • 62.
    6262MARCH 2017 Agency Contactinformation Haryana State Industrial and Infrastructure Development Corporation Ltd (HSIIDC) Plot No C-13-14, Sector 6, Panchkula-134109 Phone: 91-172-2590 481 Fax: 91-172-2590 474 E-mail: info@hsiidc.org Website: www.hsiidc.org Haryana Urban Development Authority (HUDA) C-3, Sector-6, Panchkula Phone: 91-172-2567 857 E-mail: huda@hry.nic.in Website: www.huda.gov.in Haryana Finance Corporation (HFC) Bays 17-18-19, Sector 17-A, Chandigarh-160017 Phone: 91-172-2702 755-57 Fax: 91-172-2702 666 E-mail: mdhfc@airtelmail.in Website: www.hfcindia.org Haryana State Electronics Development Corporation Ltd (HARTRON) SCO-109-110, Sector 17-B, Chandigarh -160017 E-mail: hartron@hartron.org Website: www.hartron.org.in For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA CONTACT LIST
  • 63.
    6363MARCH 2017 Approvals andclearances required Department Estimated time Site clearances and No-objection Certificate Department of Environment/Haryana Pollution Control Board Site and/or environment clearance: 60 days No-objection certificate to establish: 7 days No-objection certificate to operate: 30 days Renewal of consent: 21 days Approval, No-objection Certificate and change of industrial land Department of Town and Country Planning Change of land use in industrial zone: 30 days No objection certificate for establishment of industrial unit under the Urban Area Act: 15 days Approval of building plan: 30 days Approval and licence Labour Department/ Chief Inspector of Factories Approval of factory plan under the Factories Act, 1948 (Act 63 of 1948): 90 days Licence for running factory: 15 days Release of power connection Uttar Haryana Bijli Vitran Nigam/Dakshin Haryana Bijli Vitran Nigam Load up to 20 KW: 21 days Load up to 70 KW: 45 days Load above 250 KW: 60 days Load above 1 MW: 60 days Sales tax Excise and Taxation Sales tax registration: 15 days For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA KEY APPROVALS REQUIRED
  • 64.
    6464MARCH 2017 Cost parameterCost estimate Source Industrial land (per sq m) US$ 28.7-67 Industry sources Office space rent (per sq ft) Gurgaon: US 31 cents to US 74 cents per month Industry sources Residential rent (2,000 sq ft) US$ 287 to US$ 478 per month Industry sources Five-star hotel room rent US$ 80.4 per room per night Leading hotels in the state Power (per kWh) Commercial & Industrial: US 9.6 cents Industry sources Water (per 1,000 litres) Commercial & Industrial: US 9.6 cents Water Supply and Sanitation Department For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA COST OF DOING BUSINESS IN HARYANA As per the World Bank and Department of Industrial Policy and Promotion (DIPP) report - Assessment of State Implementation of Business Reforms 2016, the state ranked 6th in the Ease of Doing Business Index.
  • 65.
    6565MARCH 2017 Haryana Sportsand Physical Fitness Policy 2015 • The policy aims at two themes, namely - Sports for All and Excellence in Sports • The policy covers five major goals such as - introduction to sports, recreational sports, competitive sports, high performance sports and sports for development Read more Objectives For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA STATE ACTS & POLICIES … (1/4) New Integrated Licensing Policy (NILP) 2015 • To develop hyper & high potential urban complexes in the state • To allow real estate developers in setting up projects that are less than 100 acres of area (According to Government of Haryana) Read more Objective Enterprise Promotion Policy, 2015 • The major objectives of this policy is to facilitate ease of doing business in the state, reduction in cost of doing business in order to attract more number of players, and have an increased focus on MSMEs Read more Objectives
  • 66.
    6666MARCH 2017 Forupdated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA STATE ACTS & POLICIES … (2/4) Haryana Special Economic Zone (Amendment) Act 2010 • To amend the Haryana Special Economic Zone Act, 2005. Read more Objective Industrial and Investment Policy 2011 • To achieve higher, sustainable and inclusive economic growth by attracting investments in a focussed and structured manner in potential areas. • Encourage private sector investment and promote the manufacturing sector as a key economic driver Read more Objectives Rehabilitation and Resettlement Policy, 2010 • To smoothen out the land acquisition process under the Land Pooling Scheme. • To make fair payment of market value as compensation for land to land owners. Read more Objectives
  • 67.
    6767MARCH 2017 Information TechnologyPolicy (IT Policy) 2000 • To upgrade the standard and quality of administration, particularly in social and public service sectors. • To promote IT literacy and education in the state. • To attract investments in the IT industry and encourage private sector participation. Read more Objectives Haryana Special Economic Zone (SEZ) Act 2005 • To promote industrial townships with world-class infrastructure and create a conducive investment climate for export promotion. Read more Objective For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA STATE ACTS & POLICIES … (3/4) Haryana Tourism Policy 2008 • To increase the earnings from tourism inflow at the rate of 10.0% annually. • To promote sustainable tourism by encouraging a constructive and mutually beneficial partnership between the public and private sectors for economic development and employment generation. Read more Objectives
  • 68.
    6868MARCH 2017 Land PoolingScheme • To acquire land for development of industrial infrastructure in a planned manner by the HSIIDC. • To provide land owners with an option to become partners in the development process. Read more Objectives Labour Policy • To implement labour laws for ensuring proper working conditions and labour standards. • To improve working conditions for women and eliminate all forms of child labour. • To train and retain employees and officers. Read more Objectives For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA STATE ACTS & POLICIES … (4/4) Public Private Partnership Policy • To facilitate private sector participation in upgrading, developing and expanding the state’s physical and social infrastructure. Read more Objective Industrial Infra Development Scheme • Formulated in January 2017, to promote uniform regional and sustainable growth across the state, including in backward areas. Another objective of the scheme is to provide sufficient width of road connectivity between the nearest states. Read more Objective
  • 69.
    6969MARCH 2017 Year INRequivalent of one US$ 2004-05 44.81 2005-06 44.14 2006-07 45.14 2007-08 40.27 2008-09 46.14 2009-10 47.42 2010-11 45.62 2011-12 46.88 2012-13 54.31 2013-14 60.28 2014-15 60.28 2015-16 65.46 2016-17E 67.23 Average exchange rates For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA ANNEXURE Source: Reserve Bank of India
  • 70.
    7070MARCH 2017 India BrandEquity Foundation (IBEF) engaged TechSci to prepare this presentation and the same has been prepared by TechSci in consultation with IBEF. All rights reserved. All copyright in this presentation and related works is solely and exclusively owned by IBEF. The same may not be reproduced, wholly or in part in any material form (including photocopying or storing it in any medium by electronic means and whether or not transiently or incidentally to some other use of this presentation), modified or in any manner communicated to any third party except with the written approval of IBEF. This presentation is for information purposes only. While due care has been taken during the compilation of this presentation to ensure that the information is accurate to the best of TechSci and IBEF’s knowledge and belief, the content is not to be construed in any manner whatsoever as a substitute for professional advice. TechSci and IBEF neither recommend nor endorse any specific products or services that may have been mentioned in this presentation and nor do they assume any liability or responsibility for the outcome of decisions taken as a result of any reliance placed on this presentation. Neither TechSci nor IBEF shall be liable for any direct or indirect damages that may arise due to any act or omission on the part of the user due to any reliance placed or guidance taken from any portion of this presentation. For updated information, please visit www.ibef.org HARYANA THE BREAD BASKET OF INDIA DISCLAIMER
