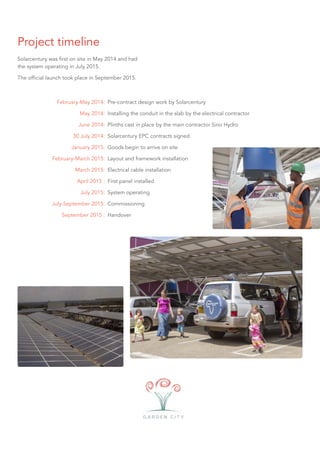

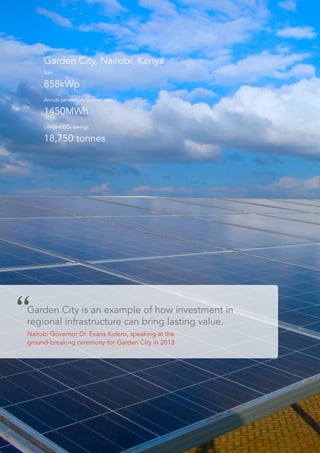

The document discusses a 858kWp solar carport system installed at Garden City Mall in Nairobi, Kenya. The system includes 3,364 solar panels and provides shade for 454 parking spaces. It generates approximately 1,450 MWh of clean solar electricity annually and cuts carbon emissions by around 750 tonnes per year. The dual-mode system provides solar power during the day and switches to generators during outages to provide reliable power. Garden City Mall is the first mixed-use development in East Africa to receive LEED green building certification.
