P a g e | 1
EXECUTIVE SUMMARY
P a g e | 2

The Company
Gicha Ressha Train (GRT) is a private firm formed in 2014 to provide nation –
side railroad and transportation system for people traveling to Northern Luzon. Aiming
rehabilitates and modernizes transport facilities to effectively and efficiently performed
mandated tasks. As the economic grows, it was essential to facilitate the restoration of
abandoned Manila – Dagupan railroad.
The main office is located at Natividad Building, T.M. Kalaw Street Ermita,
Manila.
GRT is determined to improve access and mobility for residents, employees and
visitors to North Luzon. Minimize total travel time, transfers, and changes of mode by
integrating the system. Dedicated to provide convenient access and improve
connectivity to the regional transit system. Enhance the public image of the proposed
transit improvements. Build community and political support through effective
communication and integration with local and regional plans. Enhances the physical
environment wherever possible. Implement an alternative that minimizes adverse
impacts on the environment. Minimize air and noise pollution, vibration impacts,
disturbance of public facilities, traffic and parking impacts.
The company will be headed by the General Manager with the support of his
subordinates.
The Service

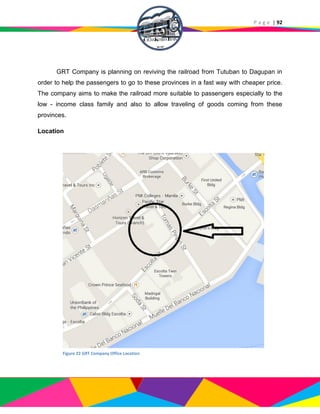

GRT Company is planning on reviving the railroad from Tutuban to Dagupan in
order to help the passengers to go along those provinces in a fast way with cheaper
price. The company aims to make the railroad more suitable to passengers especially to
the low - income class family and also to allow traveling of goods coming from these
provinces.
P a g e | 3
The Market
Quality and safety traveling are the priorities of our services. Since there is
already a railroad track from Tutuban to Dagupan, our primary target market will be the
passengers going from Manila to Bulacan, Pampanga, Tarlac and Pangasinan and vice
versa for leisure or business purposes. The total population target is 631,351.
The Company’s Competitive Edge
Quality and safety is guaranteed to the passengers in their whole trip.

For a strong and reliable public mass transit.
Financing
Gicha Ressha Train will be financed by three investors with the capital of Php
10,000,000,000. The capital will be distributed for the current and long-term assets for
the operation of the company.
P a g e | 4
MANAGEMENT
ASPECT
P a g e | 5

MANAGEMENT ASPECT

This chapter tackles the organization act and evaluation requirements in
establishing business of any kind. This section focuses on different strategies and
policies to be established and implemented during the course of the business. Effective
organizational set-up made to be determined and define the duties and responsibilities
of every personnel and to delegate and define each power in performing their respective
assignments to attain the success of the business.
Filipinos are very known to be as family-oriented. Some are still living with their
parents even after they have their own families, and some get separated and tried to
live on their own, and some did travel to find for their future in the urban like Manila and
get stocked or chose to live in it. GRT Company is a company that aims to connect the
urban cities to the rural areas and provinces in the Northern part of the country by
reopening and reoperation of the late Northrail Line of Philippine National Railway. A
business can never be form without its founder and support. Management is the very
core of a business. They are the ones who’s running and leading the business into its
success, or into its loss.

THE COMPANY
The name of the company is Gicha Ressha Train Company. The name Gicha is
a Korean word meaning train. The name Ressha is a Japanese word meaning railroad.
The name Train comes from the word itself because the firm’s line of industry is about
railroad system. Translating the company’s name will be “Train Railroad Train” because
this company is all about the railroad system in the Philippines specifically the Northrail
Line of the Philippine National Railway or PNR. The founder of the company are mainly
P a g e | 6
fanatics of the Korean and Japanese culture so they have chosen to use the foreign
languages of “train” and “railroad” to form the company’s name.
COMPANY LOGO
The logo will serve as the symbol of the company. In the figure below, the initials
are GRT and forming an image of a train. The initials stand for Gicha Ressha Train.
Figure 1 Company Logo

P a g e | 7
COMPANY MISSION
GRT Company mission is to give the populace the benefit of using a fast, safe,
reliable, and cheaper mobility access to rural centers of the northern part of the country
through the development, reconstruction, and maintenance of the Northrail line of
Philippine National Railway system.
COMPANY VISION
GRT Company envisions itself to be the country’s successful and leading
transportation system that connects urban and rural areas, and mostly the people of
these areas.
COMPANY GOAL AND OBJECTIVES
Gicha Ressha Train Co. aims to reconstruct and reopen the North Main Line system
of Philippine National Railway or PNR Northrail that travel from Tutuban, Manila
(Terminal Station) crossing into different rural areas and provinces to Dagupan,
Pangasinan as the end terminal station, and vice versa.
 To reconstruct the late Northrail line of Philippine National Railway
 To operate the Northrail line of Philippine National Railway
 To maintain the operation of the Northrail line of Philippine National Railway
 To produce a fast, safe, reliable, and cheaper mode of transportation to the
country’s Northern provinces and areas

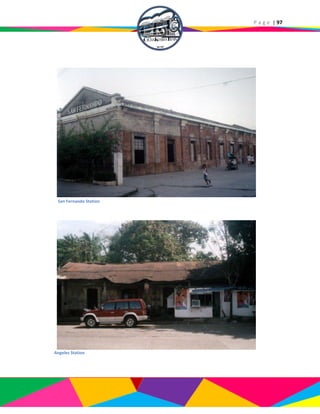

P a g e | 8

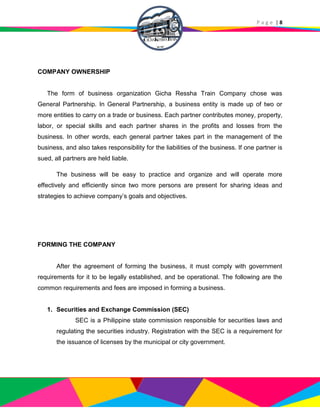

COMPANY OWNERSHIP
The form of business organization Gicha Ressha Train Company chose was
General Partnership. In General Partnership, a business entity is made up of two or
more entities to carry on a trade or business. Each partner contributes money, property,
labor, or special skills and each partner shares in the profits and losses from the
business. In other words, each general partner takes part in the management of the
business, and also takes responsibility for the liabilities of the business. If one partner is
sued, all partners are held liable.
The business will be easy to practice and organize and will operate more
effectively and efficiently since two more persons are present for sharing ideas and
strategies to achieve company’s goals and objectives.
FORMING THE COMPANY

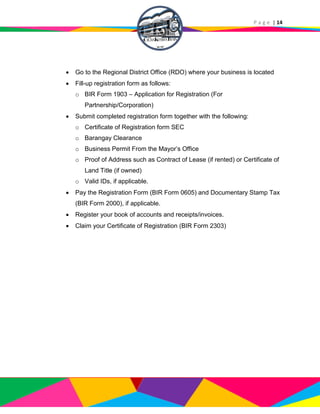

After the agreement of forming the business, it must comply with government
requirements for it to be legally established, and be operational. The following are the
common requirements and fees are imposed in forming a business.
1. Securities and Exchange Commission (SEC)
SEC is a Philippine state commission responsible for securities laws and

regulating the securities industry. Registration with the SEC is a requirement for
the issuance of licenses by the municipal or city government.
P a g e | 9
The following are the requirements for the SEC registration:
a. Name Verification Slip
b. Accomplished Registration Data Sheet
c. Articles of partnership
2. Department of Trade and Industry (DTI)
One of DTI’s functions is to administer the registration of business names.
Business name registration is compulsory and must be completed before the
business starts operating. By registering the business name with the DTI, the
proprietor is assured that no other individual or group may legally use the
business name anywhere in the Philippines.
The following requirements should be fulfilled:
a. Registration Fee
b. SEC Certificate
c. Articles of partnership

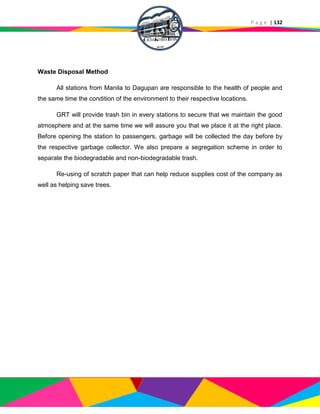

3. Bureau of Internal Revenue (BIR)
For taxation purposes, every business has to register with the BIR before the
commencement of its operation. Any business should secure a company number
and shall register with appropriate Revenue District Office (RDO) which has
jurisdiction over the place where the main office is located. The company Tax
number is permanent and it is to be used by business firm for several business
purposes.
The registration procedures are the following:
a. Secure a permanent record file number of Tax Identification Number;
b. Register the business name with the BIR Revenue District Office; and
P a g e | 10
c. Pay the prescribed fees
d. Apply for individual income tax return.
4. Municipal Permits or Licenses
All businesses are required to secure a mayor’s permit or municipal license
from the municipality or city where they are located.
The following permits and licenses are needed in starting a particular business:
a. Mayor’s Permit
b. Business Tax
c. Garbage Fee
d. Sanitary Permit
e. Signboards/Billboards
f. Electric Permit
The processing for the application of Mayor’s Permit, the requirement includes:
a. Photocopy of Articles of partnership
b. Photocopy of Certificates of SEC Registration
c. Photocopy of DTI Registration
d. Sanitary Permit secured from the municipal. Health Office that includes
sanitary fee and garbage fee
e. Fire Safety Permit
f. Building Permit from the City Engineer’s Office
g. Three (3) copies of business application form
P a g e | 11

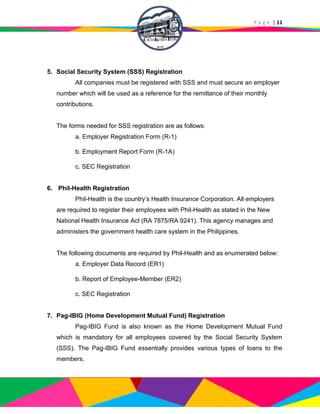

5. Social Security System (SSS) Registration
All companies must be registered with SSS and must secure an employer
number which will be used as a reference for the remittance of their monthly
contributions.
The forms needed for SSS registration are as follows:
a. Employer Registration Form (R-1)
b. Employment Report Form (R-1A)
c. SEC Registration
6. Phil-Health Registration
Phil-Health is the country’s Health Insurance Corporation. All employers
are required to register their employees with Phil-Health as stated in the New
National Health Insurance Act (RA 7875/RA 9241). This agency manages and
administers the government health care system in the Philippines.
The following documents are required by Phil-Health and as enumerated below:
a. Employer Data Record (ER1)
b. Report of Employee-Member (ER2)
c. SEC Registration
7. Pag-IBIG (Home Development Mutual Fund) Registration
Pag-IBIG Fund is also known as the Home Development Mutual Fund
which is mandatory for all employees covered by the Social Security System
(SSS). The Pag-IBIG Fund essentially provides various types of loans to the
members.
P a g e | 12
BASIC REQUIREMENTS AND PROCEDURES IN REGISTERING A BUSINESS
1. Reserve and Register Your Business Name in Securities and Exchange
Commission (SEC), as follows:
 Check if your desired business name is available via SEC online website
or at SEC Office in Mandaluyong
 If available, register/reserve your business name via SEC online website
or at SEC Name Verification Unit – SEC Office in Mandaluyong
 Prepare, sign and notarize the following:
o Articles of partnership;
o By Laws
o Treasurer’s Affidavit; and
o Joint affidavit of two incorporators undertaking to change corporate
name immediately upon receipt of notice or directive from the
Securities and Exchange Commission that another corporation,
partnership, or person has acquired a prior right to the use of that
name or that name has been declared misleading, deceptive,
confusingly similar to a registered name, or contrary to public morals,
good customs or public policy. (Not required if the Articles of
Incorporation have a provision on this commitment).
 Submit notarized documents to SEC Office in Mandaluyong City
 Claim your SEC Certificate of Registration
Processing Time: At least one (1) week upon submission of complete
documents
2. Acquire Barangay Clearance
Once the corporation is registered with SEC the next step is to get a
barangay clearance in the barangay where your business is located.

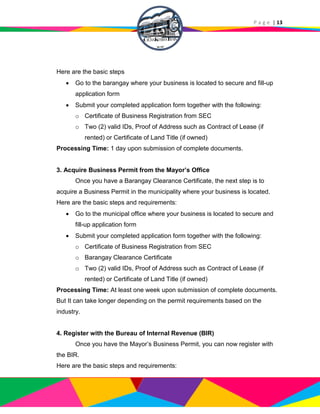

P a g e | 13
Here are the basic steps
 Go to the barangay where your business is located to secure and fill-up
application form
 Submit your completed application form together with the following:
o Certificate of Business Registration from SEC
o Two (2) valid IDs, Proof of Address such as Contract of Lease (if
rented) or Certificate of Land Title (if owned)
Processing Time: 1 day upon submission of complete documents.
3. Acquire Business Permit from the Mayor’s Office
Once you have a Barangay Clearance Certificate, the next step is to
acquire a Business Permit in the municipality where your business is located.
Here are the basic steps and requirements:
 Go to the municipal office where your business is located to secure and
fill-up application form
 Submit your completed application form together with the following:
o Certificate of Business Registration from SEC
o Barangay Clearance Certificate
o Two (2) valid IDs, Proof of Address such as Contract of Lease (if
rented) or Certificate of Land Title (if owned)
Processing Time: At least one week upon submission of complete documents.
But It can take longer depending on the permit requirements based on the
industry.
4. Register with the Bureau of Internal Revenue (BIR)
Once you have the Mayor’s Business Permit, you can now register with
the BIR.
Here are the basic steps and requirements:
P a g e | 14
 Go to the Regional District Office (RDO) where your business is located
 Fill-up registration form as follows:
o BIR Form 1903 – Application for Registration (For
Partnership/Corporation)
 Submit completed registration form together with the following:
o Certificate of Registration form SEC
o Barangay Clearance
o Business Permit From the Mayor’s Office
o Proof of Address such as Contract of Lease (if rented) or Certificate of
Land Title (if owned)
o Valid IDs, if applicable.
 Pay the Registration Form (BIR Form 0605) and Documentary Stamp Tax
(BIR Form 2000), if applicable.
 Register your book of accounts and receipts/invoices.
 Claim your Certificate of Registration (BIR Form 2303)
P a g e | 15

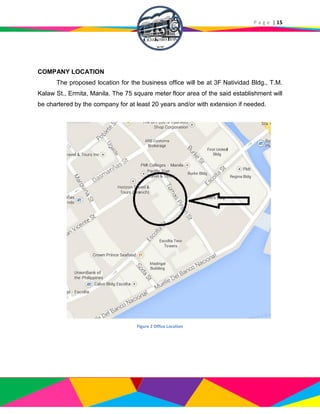

COMPANY LOCATION
The proposed location for the business office will be at 3F Natividad Bldg., T.M.
Kalaw St., Ermita, Manila. The 75 square meter floor area of the said establishment will
be chartered by the company for at least 20 years and/or with extension if needed.
Figure 2 Office Location
P a g e | 16
OPERATING HOURS AND WORK SCHEDULES
The Gicha Ressha Train Company office will be operating from 8:00AM to
5:00PM every weekdays, Monday to Friday. Administrative employees will be having
morning break of 15-minutes break from 10:00AM, lunch break of 30 minutes from
12:00 noon, and another 15-minutes break from 2:45PM. Since the company is in
partnership with the Philippine National Railway administration, the employees require
to have a field work and site inspection to check for the progress of the project, an
employee has to file for an itinerary letter a day before the appointment date if he/she is
going on the field.
The GRT Company trains will be operating from 5:00 AM to 11:00 PM everyday,
Monday to Sunday. Employees or personnel from the stations like security guards,
ticket operators, and maintenance personnel are require to work a minimum of eight (8)
hours a day inclusive of their breaks. Lunch and break time are not too tight as long as
they follow the rules regarding the subject, and can perform task assigned to them.
Their schedules will be shifting basis so that the station will still be operational along the
day.
P a g e | 17

ORGANIZATIONAL CHART
Figure 3 Organizational Chart
The figure shows the organizational structure of Gicha Ressha Train Corporation
from top to lower management who would run the company. The business is classified
as Corporation as agreed by the owners and due to the complexity of the purpose of the
project.
The General Manager will overlook to the company to reach its goals and serve
its purpose for greater good which will be supported by a Construction
Supervisor/Estimator, Financial Planner, Operations Engineer, Project Engineer Human
P a g e | 18
Resource Manager and their assistants. Other personnel will be hired then for their
designated works such as Train Operators, Ticket Vendor, Maintenance Personnel, and
Security Guard.
JOB DESCRIPTIONS AND QUALIFICATIONS
 GENERAL MANAGER
Job Description
 Increases management's effectiveness by recruiting, selecting, orienting,
training, coaching, counseling, and disciplining managers; communicating
values, strategies, and objectives; assigning accountabilities; planning,
monitoring, and appraising job results; developing incentives; developing a
climate for offering information and opinions; providing educational
opportunities.
 Develops strategic plan by studying technological and financial opportunities;
presenting assumptions; recommending objectives.
 Accomplishes subsidiary objectives by establishing plans, budgets, and
results measurements; allocating resources; reviewing progress; making mid-
course corrections.
 Coordinates efforts by establishing procurement, production, marketing, field,
and technical services policies and practices; coordinating actions with
corporate staff.
 Builds company image by collaborating with customers, government,
community organizations, and employees; enforcing ethical business
practices.
 Maintains quality service by establishing and enforcing organization
standards.
P a g e | 19
 Maintains professional and technical knowledge by attending educational
workshops; reviewing professional publications; establishing personal
networks; benchmarking state-of-the-art practices; participating in
professional societies.
 Contributes to team effort by accomplishing related results as needed.
Qualifications
 Male/Female, 30-35years old
 Graduate of Industrial Engineering or any managerial course
 With knowledge in Management Engineering
 Minimum of 3 years of experience in Managerial Position
 OPERATIONS MANAGER
Job Description
 Identifies operational problems by observing and studying system functioning
and performance results; investigating complaints and suggestions;
interviewing process supervisors and operators; completing troubleshooting
procedures.
 Identifies operational priorities by assessing operational objectives;
determining project objectives, such as, efficiency, cost savings, energy
conservation, operator convenience, safety, environmental quality; estimating
relevance, time, and costs.
 Develops operational solutions by defining, studying, estimating, and
screening alternative solutions; calculating economics; determining impact on
total system.
P a g e | 20

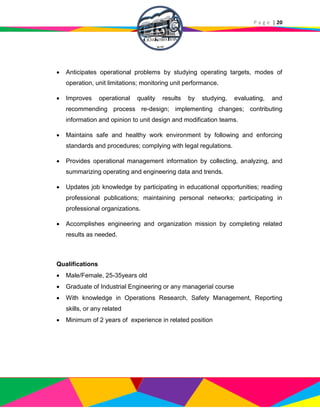

 Anticipates operational problems by studying operating targets, modes of
operation, unit limitations; monitoring unit performance.
 Improves operational quality results by studying, evaluating, and
recommending process re-design; implementing changes; contributing
information and opinion to unit design and modification teams.
 Maintains safe and healthy work environment by following and enforcing
standards and procedures; complying with legal regulations.
 Provides operational management information by collecting, analyzing, and
summarizing operating and engineering data and trends.
 Updates job knowledge by participating in educational opportunities; reading
professional publications; maintaining personal networks; participating in
professional organizations.
 Accomplishes engineering and organization mission by completing related
results as needed.
Qualifications
 Male/Female, 25-35years old
 Graduate of Industrial Engineering or any managerial course
 With knowledge in Operations Research, Safety Management, Reporting
skills, or any related
 Minimum of 2 years of experience in related position
P a g e | 21
 FIELD SUPERVISOR
Job Description
 Prepare daily production reports (passenger counts of the train)
 Assign and coordinate the daily task of laborers
 Report any field problems to the General Manager
Qualifications
 Male, 23-30 years old
 Graduate of Mechanical, or any related course
 With knowledge in Requirements Analysis, Design Skills, Project
Management, Manufacturing Methods and Procedures, Process
Improvement, Technical Understanding, Documentation Skills, Safety
Management, Supervision
 Service oriented and hardworking
 Good observation and reporting skills
 RAILWAY ENGINEER
Job Description
 Develops project objectives by reviewing project proposals and plans;
conferring with management.
 Determines project responsibilities by identifying project phases and
elements; assigning personnel to phases and elements; reviewing bids from
contractors.
 Determines project specifications by studying product design, customer
requirements, and performance standards; completing technical studies;
preparing cost estimates.
P a g e | 22
 Confirms product performance by designing and conducting tests.
 Determines project schedule by studying project plan and specifications;
calculating time requirements; sequencing project elements.
 Maintains project schedule by monitoring project progress; coordinating
activities; resolving problems.
 Controls project plan by reviewing design, specifications, and plan and
schedule changes; recommending actions.
 Controls project costs by approving expenditures; administering contractor
contracts.
 Prepares project status reports by collecting, analyzing, and summarizing
information and trends; recommending actions.
 Maintains safe and clean working environment by enforcing procedures,
rules, and regulations.
 Maintains project data base by writing computer programs; entering and
backing up data.
 Maintains product and company reputation by complying with federal and
state regulations.
 Contributes to team effort by accomplishing related results as needed.
Qualifications
 Male/Female, 25-35years old
 Graduate of Industrial Engineering , Civil, Mechanical Engineering, or any
related course
 With knowledge in Requirements Analysis, Design Skills, Project
Management, Manufacturing Methods and Procedures, Process
P a g e | 23
Improvement, Technical Understanding, Documentation Skills, Safety
Management, Supervision, CAD, CAD/CAM Circuit Design
 Minimum of 2 years of experience in related position
 ASSISTANT ENGINEER
Job Description
 Determines engineering requirements by conducting inspections and
analytical tests; analyzing and synthesizing data; maintaining control charts;
determining root causes; preparing bid specifications.
 Resolves engineering problems by collecting and analyzing information;
researching, analyzing, adapting, and modifying engineering techniques;
recommending solutions; preparing drawings, schematics, and diagrams;
evaluating components, materials, and suppliers; resolving design integration
issues; developing specifications and safety standards; performing
installations.
 Verifies engineering applications by conducting tests and inspections; building
and analyzing models and simulations; conducting laboratory experiments
and measurements.
 Maintains project team accomplishments by communicating essential
information; coordinating actions; obtaining expert input; reviewing open
issues and action items; contributing information to team meetings and
reports; escalating project completion impediments.
 Meets cost standards by preparing cost-benefit analyses; tracking and
reporting expenses.
P a g e | 24
 Complies with codes and regulations by complying with requirements;
preparing permit applications, plans, and compliance reports.
 Prepares guidelines by describing operational and testing methods and
procedures.
 Maintains and improves quality results by completing quality assurance tests;
following standards; studying, evaluating, and re-designing processes;
implementing changes.
 Ensures operation of analytical equipment by calibrating equipment;
completing preventive maintenance requirements; following manufacturer's
instructions; troubleshooting malfunctions; calling for repairs; maintaining
equipment inventories; evaluating new equipment and techniques.
 Keeps supplies ready by inventorying stock; placing orders; verifying receipt.
 Prepares engineering reports by collecting, analyzing, and summarizing data
and trends; entering data and generating reports and presentations;
performing calculations.
 Updates job knowledge by tracking and understanding emerging engineering
practices; participating in educational opportunities and professional
organizations; reading professional publications; maintaining personal
networks.
 Enhances engineering and organization reputation by accepting ownership
for accomplishing new and different requests; exploring opportunities to add
value to job accomplishments.
P a g e | 25
Qualifications
 Male/Female, 20-28 years old
 Graduate of Industrial Engineering , Civil, Mechanical Engineering or any
related course
 With knowledge in Analyzing Information , General Math Skills, Reporting
Research Results, Dealing with Complexity, Presentation Skills, Verbal
Communication, Written Communication, Drafting, Analytical Tools, Attention
to Detail, Innovation or any related
 No experience required
 Willingness to learn
 FINANCIAL PLANNER
Job Description
 Defines financial situtation by completing quantitative analyses.
 Evaluates optional plans by identifying outcomes and potential returns.
 Values assets by appraising current condition; assessing potential.
 Recommends debt structures by analyzing refinancing options.
 Builds financial database by identifying sources of information; assembling,
verifying, and backing up data.
 Accomplishes organization goals by accepting ownership for accomplishing
new and different requests; exploring opportunities to add value to job
accomplishments.
 Updates job knowledge by participating in educational opportunities; reading
professional publications; maintaining personal networks; participating in
professional organizations.
P a g e | 26
 Recommends financial actions by assessing options in relation to
organization goals.
 Prepares financial reports by collecting, formatting, analyzing, and explaining
information.
 Protects operations by keeping financial information confidential.
 Maintains technical knowledge by attending educational workshops;
reviewing publications.
 Contributes to team effort by accomplishing related results as needed.
Qualifications
 Female, 25-30 years old
 Graduate of Accountancy or any related course
 With knowledge in Business Knowledge, Corporate Finance, Financial
Planning and Strategy, Forecasting, Accounting, Developing Budgets,
Analyzing Information , General Math Skills, Reporting Research Results,
Managing Profitability, Electronic Payment Technology Risk-Taking, Tracking
Budget Expenses, Financial Planning and Strategy, Statistical Analysis,
Reporting Research Results, Database Design, Strategic Planning,
Forecasting, Analyzing Information , Conceptual Skills, Financial Skills
 Minimum of 2 years of experience in related position
P a g e | 27
 HUMAN RESOURCE MANAGER
Job Description
 Maintains the work structure by updating job requirements and job
descriptions for all positions.
 Maintains organization staff by establishing a recruiting, testing, and
interviewing program; counseling managers on candidate selection;
conducting and analyzing exit interviews; recommending changes.
 Prepares employees for assignments by establishing and conducting
orientation and training programs.
 Maintains a pay plan by conducting periodic pay surveys; scheduling and
conducting job evaluations; preparing pay budgets; monitoring and
scheduling individual pay actions; recommending, planning, and
implementing pay structure revisions.
 Ensures planning, monitoring, and appraisal of employee work results by
training managers to coach and discipline employees; scheduling
management conferences with employees; hearing and resolving employee
grievances; counseling employees and supervisors.
 Maintains employee benefits programs and informs employees of benefits by
studying and assessing benefit needs and trends; recommending benefit
programs to management; directing the processing of benefit claims;
obtaining and evaluating benefit contract bids; awarding benefit contracts;
designing and conducting educational programs on benefit programs.
 Ensures legal compliance by monitoring and implementing applicable human
resource federal and state requirements; conducting investigations;
maintaining records; representing the organization at hearings.
P a g e | 28
 Maintains management guidelines by preparing, updating, and
recommending human resource policies and procedures.
 Maintains historical human resource records by designing a filing and retrieval
system; keeping past and current records.
 Maintains professional and technical knowledge by attending educational
workshops; reviewing professional publications; establishing personal
networks; participating in professional societies.
 Completes human resource operational requirements by scheduling and
assigning employees; following up on work results.
 Maintains human resource staff by recruiting, selecting, orienting, and training
employees.
 Maintains human resource staff job results by counseling and disciplining
employees; planning, monitoring, and appraising job results.
 Contributes to team effort by accomplishing related results as needed.
Qualifications
 Candidate must possess at least a Bachelor’s/College Degree in Psychology
or closely related field
 Male/Female 25-30 years old
 At least 2-3 years working experience in the related field
 Ability to communicate effectively both written and verbally
 With knowledge in Hiring, Human Resources Management, Benefits
Administration, Performance Management, Communication Processes,
Compensation and Wage Structure, Supports Diversity, Classifying
P a g e | 29
Employees, Employment Law, Laws Against Sexual Harassment,
Organization
 HUMAN RESOURCE ADMINISTRATIVE ASSISTANT
Job Description
 Provides job candidates by screening, interviewing, and testing applicants;
notifying existing staff of internal opportunities; maintaining personnel records;
obtaining temporary staff from agencies.
 Pays employees by calculating pay; distributing checks; maintaining records.
 Administers student loan, medical insurance, savings bond, and disability
programs by advising employees of eligibility; providing application
information; helping with form completion; verifying submission; notifying
employees of approvals.
 Monitors unemployment claims by reviewing claims; substantiating
documentation; requesting legal counsel review.
 Maintains human resources records by recording new hires, transfers,
terminations, changes in job classifications, merit increases; tracking
vacation, sick, and personal time.
 Orients new employees by providing orientation information packets;
reviewing company policies; gathering withholding and other payroll
information; explaining and obtaining signatures for benefit programs.
 Documents human resources actions by completing forms, reports, logs, and
records.
 Updates job knowledge by participating in educational opportunities; reading
professional publications.
P a g e | 30
 Accomplishes human resources department and organization mission by
completing related results as needed.
Qualifications
 Candidate must possess at least a Bachelor’s/College Degree in Psychology
or closely related field
 Male/Female 20-30 years old
 Ability to communicate effectively both written and verbally
 No experience required
 Willingness to learn
 TRAIN OPERATOR/DRIVER
Job Description
 Checking equipment and engines before a journey starts
 Contacting control centres for information about routes and any problems
 Following signalling instructions during the journey
 Making passenger announcements
 Controlling automatic doors
 Positioning and handing over engines to drivers on the next shift.
Qualifications
 High school diploma or equivalent.
 Must be at least 21 years of age.
 Professional driving experience within the last three years.
 Experience may include, but not be limited to, previous operation of light rail
vehicle, transit bus/school bus and/or truck. Not more than five (5) points
assessed against motor vehicle record (MVR) in the past two (2) years as
P a g e | 31

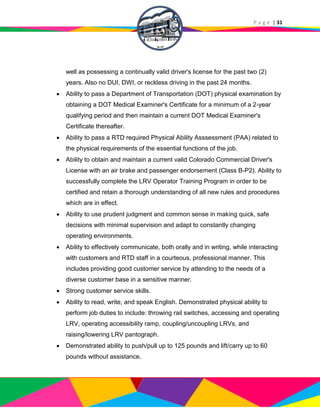

well as possessing a continually valid driver's license for the past two (2)
years. Also no DUI, DWI, or reckless driving in the past 24 months.
 Ability to pass a Department of Transportation (DOT) physical examination by
obtaining a DOT Medical Examiner's Certificate for a minimum of a 2-year
qualifying period and then maintain a current DOT Medical Examiner's
Certificate thereafter.
 Ability to pass a RTD required Physical Ability Asssessment (PAA) related to
the physical requirements of the essential functions of the job.
 Ability to obtain and maintain a current valid Colorado Commercial Driver's
License with an air brake and passenger endorsement (Class B-P2). Ability to
successfully complete the LRV Operator Training Program in order to be
certified and retain a thorough understanding of all new rules and procedures
which are in effect.
 Ability to use prudent judgment and common sense in making quick, safe
decisions with minimal supervision and adapt to constantly changing
operating environments.
 Ability to effectively communicate, both orally and in writing, while interacting
with customers and RTD staff in a courteous, professional manner. This
includes providing good customer service by attending to the needs of a
diverse customer base in a sensitive manner.
 Strong customer service skills.
 Ability to read, write, and speak English. Demonstrated physical ability to
perform job duties to include: throwing rail switches, accessing and operating
LRV, operating accessibility ramp, coupling/uncoupling LRVs, and
raising/lowering LRV pantograph.
 Demonstrated ability to push/pull up to 125 pounds and lift/carry up to 60
pounds without assistance.
P a g e | 32
 Ability to walk on track ballast, on uneven ground, sit for an extended period
of time, and work in various outdoor weather.
 Ability to be re-certified periodically on standard operating procedures as well
as through examination on all Rules and as hands-on proficiency. Ability to
maintain a high performance level of dependability, reliability and safety as
demonstrated in the past six (6) months by:
o -No more than three (3) occurrences and three (3) tardies.
o -No more than eighty (80) hours unscheduled work absences.
o -Extenuating circumstances will be reviewed.
 Acceptable driving record as demonstrated in the past six (6) months by:
o -No 'at-fault' of Class A or B safety violations.
o -No suspensions for violations of rules or operating procedures
 Ability to work unusual hours, split shifts, weekends, holidays, and overtime
as required.
 CONSTRUCTION SUPERVISOR/ESTIMATOR
Job Description
 Accomplishes construction human resource objectives by selecting, orienting,
training, assigning, scheduling, coaching, counseling, and disciplining
employees; communicating job expectations; planning, monitoring, appraising
job contributions; recommending compensation actions; adhering to policies
and procedures.
 Manages sub-contractors by locating, evaluating, and selecting sub-
contractors; monitoring and controlling performance.
 Meets operational standards by contributing construction information to
strategic plans and reviews; implementing production, productivity, quality,
P a g e | 33
and customer-service standards; resolving problems; identifying construction
management system improvements.
 Meets construction budget by monitoring project expenditures; identifying
variances; implementing corrective actions; providing non-project annual
operating and capital budget information.
 Accomplishes construction project results by defining project purpose and
scope; calculating resources required; establishing standards and protocols;
allocating resources; scheduling and coordinating staff and sub-contractors;
evaluating milestone assumptions and conclusions; resolving design
problems; evaluating and implementing change orders.
 Approves construction projects by conducting inspections at critical phases;
obtaining approvals from buyers.
 Prevents fines and interruptions by complying with, and enforcing, codes.
 Maintains safe, secure, and healthy work environment by following and
enforcing standards and procedures; complying with legal regulations.
 Updates job knowledge by tracking and understanding emerging construction
practices and standards; participating in educational opportunities; reading
professional publications; maintaining personal networks; participating in
professional organizations.
 Enhances organization reputation by accepting ownership for accomplishing
new and different requests; exploring opportunities to add value to job
accomplishments.
 Prepares work to be accomplished by gathering information and
requirements; setting priorities.
P a g e | 34
 Prepares construction budget by studying home plans; updating
specifications; identifying and projecting costs for each elevation.
 Evaluates offers to purchase by costing changes, additions, and site
requirements.
 Obtains bids from vendors and subcontractors by specifying materials;
identifying qualified subcontractors; negotiating price.
 Maintains cost keys and price masters by updating information.
 Resolves cost discrepancies by collecting and analyzing information.
 Prepares special reports by collecting, analyzing, and summarizing
information and trends.
 Maintains quality service by following organization standards.
 Maintains continuity among corporate, division, and local work teams by
documenting and communicating actions, irregularities, and continuing needs.
 Maintains professional and technical knowledge by attending educational
workshops; reviewing professional publications; establishing personal
networks; participating in professional societies.
 Contributes to team effort by accomplishing related results as needed.
Qualifications
 Male, 25-35 years old
 Graduate of Civil, Mechanical Engineering, Architecture or any related course
 With knowledge in Project Management, Quality Management, Supervision,
Managing Profitability, Delegation, Supply Management, ADA Requirements,
Civil Project Management, Estimating, Attention to Detail, Quality Focus or
any related
P a g e | 35
 Minimum of 2 years of experience in related position
 TICKET OPERATOR
Job Description
 Responsible for selling tickets to customers
 Responsible reporting daily sales and bookkeeping
Qualifications
 Must be at least high school graduate
 Female, 18-30 years old
 Service oriented and hardworking
 Good customer communication and service skills
 SECURITY GUARD
Job Description
 Maintains security and safety of people and property in assigned area on
company by patrolling areas on foot and enforcing company rules and
regulation.
Qualifications
 Candidate must possess at least a Vocational Diploma / Short Course
Certificate, Protective Services & Management or equivalent.
 At least 2 year(s) of working experience in the related field is required for this
position.
 Applicants must be willing to work on any shift.
 Male, 25 - 40 years old
P a g e | 36
 MAINTENANCE PERSONNEL (JANITOR/JANITRESS)
Job Description
 Sweep and mop floors.
 Cleaning trains and stations by emptying trash, sweeping, and cleaning
surfaces.
 Clean and disinfect laboratory equipment.
 Monitor establishment’s security and safety by performing such tasks as
locking doors after operating hours and checking electrical appliance use to
ensure that hazards are not created.
 Use cleaning solutions to remove stains and clean surfaces.
 Mix various cleaning agents.
 Clean windows, glass partitions, and mirrors, using soapy water or other
cleaners, sponges, and squeegees.
 Clean and service restrooms with mops and disinfectants.
 Identify and report possible repairs.
Qualifications
 Must be at least high school graduate
 Female, 18-30 years old
 Service oriented and hardworking
 Must be flexible and willing to work to any assigned shift
 Good customer service skills
P a g e | 37
MANAGEMENT POLICIES AND PROCEDURES
Every Policies and procedures are a vital part of business management because
it provides a baseline of internal control allows employees to understand their roles and
responsibilities within predefined limits. Basically, policies & procedures allow
management to guide operations without constant management intervention.
There are some conditions unique in our business which the employees cannot
be expected to know about unless the management calls their attention.
o Employees are expected to devote his/her time and energy toward the
performance of the duties and responsibilities assigned to him/her, which may be
changed at any time from time to time.
o Business transaction not related to work is prohibited within company premises.
o All employees are entitled to receive 60 minutes or 1 hour break daily.
o Smoking while on duty and in unauthorized places are prohibited.
Neatness and Uniform Policy
o Men are not allowed to grow their mustache and stubbles should be shaving as
soon as noticeable.
o All employees should wear proper uniform according to the rules. Employees
must wear company uniform every Monday, and Wednesday; and during field
work. Employees must wear casual attire every Tuesday, and Thursday.
Employees are free to use anything they desire to wear as long as it is
presentable.
o All employees should have clean hands and short fingernails.
Duty to Report/ Failing to Call
P a g e | 38
o All employees have a duty to report any violations of the company policies and
procedures and while they initially be reluctant to get involved, it’s important to
note that failure to report violations can have substantial consequences. In
addition to the possibility of being held personally liable for the legal or ethical
violation, they may subject to disciplinary proceedings, including termination, so
when in doubt they should speak up.
Rules of Conduct
o Employees are required to obey instructions and perform works as required or
assigned. Any insubordination or failure to obey lawful instructions with regard to
work and behavior will result to disciplinary action.
o Employees should respect the person, rights and properties of all who work with
them, particularly our customers. Acts of, or even attempts to cause physical or
psychological harm, injury, damage, loss and situations to endanger safety well-
being of the above stated persons will be subjected to disciplinary action.
o Employees are not allowed to leave the job without permission or conduct
personal affair while on duty.
Security Policies
To further protect the company premises and employees working here, the
following guidelines have been set:
o All employees (on duty or not) shall have their bags inspected by the security
personnel before going in and when coming out.
o All items take out from the company office and business establishment should be
presented to the security personnel.
o All employees are oblige to follow the building’s rules and policies.
P a g e | 39
o Safety and security is a major concern for the company because it values its
employees and customer not only for productivity but for humanity. The
enterprise will be complying on different occupational safety and health
regulations and programs mandated by different government agencies. Fire
alarm, extinguishers and other safety measures will be placed in different areas
of the establishment
Drug Abuse Prevention Policy and Procedure
Because of the harmful effects of drug abuse on the physical and well- being of
its employee, the company is committed to maintain a drug free environment. In
keeping with this commitment, drug abuse is hereby prohibited in any form. The
company’s policy is to employ a work force free from use of dangerous drugs, either on
or off the job. It is, therefore, the company policy that an employee found with the
presence of dangerous drugs in his/her system, in possession of, using, selling, trading
or offering for sale dangerous drugs during work hours or company sponsored activities
or on company’s premises, vehicles and the like may be subject to disciplinary action.
Confidential Information
In consideration for providing the employee with confidential information, the
employee shall hold and treat all confidential information in strict confidence and will not
disclose in any manner whatsoever, in whole or in part and will not use the confidential
information without the company’s prior written the consent.
P a g e | 40
EMPLOYEE LEAVING RIGHTS
1. Service Incentive Leave
Under Article 95 of the Labor Code of the Philippines, an employee who
has rendered at least (1) one year of service in a company is entitled to five (5)
days leave of absence, with pay, every year.
The phrase “one year of service” of the employee means service within
twelve (12) months, whether continuous or broken, reckoned from the date the
employee started working. The period includes authorized absences, unworked
weekly rest days, and paid regular holidays. If through individual or collective
agreement, company practice or policy, the period of the working days is less
than twelve (12) months, said period shall be considered as one year for the
purpose of determining the entitlement to the service incentive leave.
The service incentive leave may be used for sick and vacation leave
purposes. The unused service incentive leave is commutable to its money
equivalent at the end of the year.
2. Maternity Leave
This benefit applies to all female members, whether married or unmarried,
of the Social Security System (SSS) who has paid at least 3 monthly
contributions in the twelve-month period immediately preceding the semester of
her childbirth or miscarriage. Members will be entitled to maternity leave benefit
of sixty (60) days in case of normal delivery or miscarriage, or seventy-eight (78)
days, in case of Caesarian section delivery, with benefits equivalent to one
hundred percent (100%) of the average daily salary credit of the employee as
defined under the law.
P a g e | 41
3. Paternity Leave
Paternity Leave is granted to all married male employees of a company.
The purpose of this benefit is to allow the husband to lend support to his wife
during her period of recovery and/or in nursing her newborn child. Usage of
Paternity Leave shall be after the delivery. The paternity leave shall be for seven
(7) calendar days, with full pay, consisting of basic salary and mandatory
allowances fixed by the Regional Wage Board, if any, provided that his pay shall
not be less than the mandated minimum wage.
4. Parental Leave for Solo Parent
Under RA 8972, Parental leave is a benefit granted to a solo parent to
enable him/her to perform parental duties and responsibilities where physical
presence is required. Employees that are considered as a solo parent and who
have rendered service of at least (1) one year to a company are entitled to 7
working days of leave.
5. Leave for Victims of Violence against Women and their Children
Based From RA 9262, Employees who fall under the definition of “Victims
of Violence against women and their children “or otherwise known as Republic
Act 9262 and who have submitted a certification of violence shall be entitled a
leave of ten (10) days with full pay, consisting of basic salary and mandatory

allowances . The leave benefit shall cover the days that the woman employee
has to attend to medical and legal concerns.
6. Sick Leave
Employees should have reasonable opportunities for time away from work
without loss of pay to handle illness, injury, legal quarantine and attending visits
with health care providers for themselves and immediate family members and
P a g e | 42

members of their household who are dependent upon them for care during
illness or injury. Full-time employees shall accrue seven and one-half (7.5) hours
of sick leave for each two (2) months of employment and an additional seven and
one-half (7.5) hours of sick leave for each four (4) months of employment.
7. Special Leave for Women
RA 9710 is an article for Special Leave for women. Special Leave is
granted to female employees, regardless of age and civil status, with
Gynecological disorders and who have rendered at least six (6) months
continuous aggregate employment service for the last twelve (12) months prior to
surgery. The employee shall be entitled of (2) two months leave with full pay
based on her gross monthly compensation.
8. Vacation Leave
Under a Vacation Leave, each full-time employee shall be given 5 paid
working days (40 hours) vacation at the end of the first year of continuous
employment and 10 paid working days (80 hours) vacation at the end of the
second year of continuous employment. After 5 years of continuous employment,
full-time employees will be eligible for 15 paid working days (120 hours) vacation.
Vacation leave may only be used in ½ day or whole day increments.
Termination / Employee Dismissal
Termination occurs when an employer or employee ends an employee's
employment with a particular employer. Termination can be voluntary or involuntary
depending on the circumstances.
P a g e | 43
In other instances of employment termination, the employment is terminated for a
reason which is given to the employee and stated in the termination letter. Termination
for cause can occur in such situations as:
o Violation of the company code of conduct or ethics policy,
o Unacceptable Personal Conduct
o Unsatisfactory Job Performance
o Failure to follow company policy,
o Violence or threatened violence,
o Gross and habitual neglect of duty,
o Fraud,
o Commission of a crime,
o Extreme insubordination,
o Sexual harassment, or
o Watching pornography online
Resignation from work will only take effect fifteen days after submission of
resignation letter and after the resigning employee complies with the company
clearance on accountabilities.
SALARIES AND WAGES
Monthly Salary
Minimum wage is given to direct and indirect employees, wages is according to
the Department of Labor and Employment: National Wages and Productivity
Commission, underlying the sector of Service, with 16 or more than number of
employees. Each classified position is assigned to a salary range that provides, based
on similar employment in the defined labor market: minimum, mid-point, and maximum
salary rates that are competitive with rates in the external labor market consistent with
P a g e | 44
the Enterprise’ ability to pay; and proper relationships within State government
employment to maintain internal equity. Employees such as, Janitors, Construction
Workers, Ticket Operators, and Security Guard will be paid in accordance to their
hourly rate. Direct employees will work 8 hours daily with 1 hour break, and an
overtime if needed.

Computation of Minimum Wage
(Maintenance Personnel, Ticket Operator, and Security Guard)
Minimum wage: PHP 451.00
Cost of Living Allowance: PHP 15.00
Rate per day:
(Wage/per day)+COLA= 451+15 = PHP 466.00
Annual Gross Salary
The annual gross salary of employees of GRT Corporation is consisting of
annual salary of an employee before deductions are made plus the 13th month pay.
GRT Corporation has different approach of the salary computation depending
on the working days of employees. Administrative or Office Employees have only 5
working days a week or a total of 270 days a year depending on the status of the
project, and for field workers/employees a total of 324 working days in a year. Every
employee will also receive a thirteenth month pay equivalent to their monthly salary
pay.
GRT Corporation will be allotting PHP 17,002,400.00 as the total salaries of its
employees per annum, inclusive of the thirteenth month pay.
P a g e | 45
Compensation
It’s a policy of the company to compensate its employees at a level sufficient to
encourage excellence of performance and to maintain the labor market
competitiveness necessary to recruit and retain a competent work force.
The pay period of GRT Corporation will be the usual cut-off which is on the 15th
and 30th day of the month. Employees are required to give the company their bank
account numbers to be able to conduct salary payments through bank transactions.
As for the construction labors, their salary or pay period will be on a weekly basis.
Work Pay
The minimum wage would be PHP 451.00 and integration of the P15
COLA under W.O. No. NCR-17 into the basic pay which sums up to PHP 466.00
Basic Pay
GRT Company basic payments will be ranging from the minimum wage of Php
430.00 to PHP 1,360.00 per day. Wage rates of the employees will vary due to the
extent of their responsibilities and the degree of educational attained.
Fringe Benefits
1. Employees are entitled to 13th month pay and bonuses one year after
the business has established.
2. Employees are entitled of a separation pay under article 283-284 of the
labor Code of the Philippines depending on the grounds of the company’s
termination policy.
3. Promotion opportunity – this is offered to employees who are excellent
performers, shows initiative and desire to advance. High rates of pay are
given for these extra responsibilities.

P a g e | 46
4. Philhealth – the Philhealth program provides benefits for the
hospitalization of the employees.
5. SSS Benefits – a social security contribution is required to include both
the employer and employees share.
Overtime Pay
Overtime pay refers to the additional compensation for work performed beyond
eight (8) hours a day
Back Pay
Back Pay is past wages and benefits (bonus, increment, overtime, etc.) to which
an employee is entitled either because of a retroactive increase or employment
practices (such as dismissal or denial of promotion) declared unlawful by a court or
tribunal.HR automatically deletes employee name from the payroll and therefore not
paid for the days worked from previous payroll to the day to resign. The pay computed
manually which sometimes takes a while because it has to be verified and approved
by the management.
P a g e | 47
SALARY BREAKDOWN
EMPLOYEE'S BASIC SALARY ANNUAL SALARY
POSITION
EMPLOYE
E #
HOURLY
RATE
DAILY
RATE
BASIC
SALARY
2015 2016 2017 2018 2019 2020
Administrative Labor 3 Stations 6 Stations 9 Stations
General Manager 1 166.67
1,333.3
3
40,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00
Operations Engineer 1 137.50
1,100.0
0
33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
Project Engineer 1 137.50
1,100.0
0
33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
Assistant Engineer 1 95.83 766.67 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00
Construction
Supervisor/Estimator
1 137.50
1,100.0
0
33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
HR Manager 1 116.67 933.33 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00
HR Administrative
Assistant
1 95.83 766.67 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00
Financial Planning Analysts 1 116.67 933.33 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00
Direct Labor
Ticket Operator 36 58.25 466.00 13,980.00
2,013,120.0
0
4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00
Train Driver 9 62.50 500.00 15,000.00 540,000.00 1,080,000.00 1,620,000.00 1,620,000.00 1,620,000.00
Indirect Labor
Security Guards 36 58.25 466.00 13,980.00
2,013,120.0
0
4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00
Janitors/Janitress 36 58.25 466.00 13,980.00
2,013,120.0
0
4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00
TOTAL 125
1,241.4
2
9,931.3
3
297,940.0
0
2,892,000.0
0
9,471,360.0
0
16,050,720.0
0
33,828,060.0
0
22,630,080.0
0
22,630,080.0
0
Table 1.1 Employee’s Basic Salar
P a g e | 48

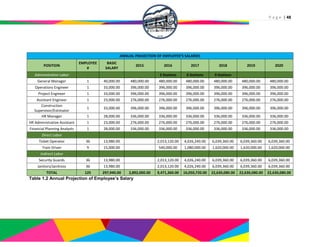

ANNUAL PROJECTION OF EMPLOYEE'S SALARIES
POSITION
EMPLOYEE
#
BASIC
SALARY
2015 2016 2017 2018 2019 2020
Administrative Labor 3 Stations 6 Stations 9 Stations
General Manager 1 40,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00
Operations Engineer 1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
Project Engineer 1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
Assistant Engineer 1 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00
Construction
Supervisor/Estimator
1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00
HR Manager 1 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00
HR Administrative Assistant 1 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00
Financial Planning Analysts 1 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00
Direct Labor
Ticket Operator 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00
Train Driver 9 15,000.00 540,000.00 1,080,000.00 1,620,000.00 1,620,000.00 1,620,000.00
Indirect Labor
Security Guards 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00
Janitors/Janitress 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00
TOTAL 125 297,940.00 2,892,000.00 9,471,360.00 16,050,720.00 22,630,080.00 22,630,080.00 22,630,080.00
Table 1.2 Annual Projection of Employee’s Salary
P a g e | 49
EMPLOYEE'S 13th MONTH PAY
POSITION
EMPLOYEE
#
BASIC
SALARY
2015 2016 2017 2018 2019 2020
Administrative Labor 3 Stations 6 Stations 9 Stations
General Manager 1 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00
Operations Engineer 1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00
Project Engineer 1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00
Assistant Engineer 1 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00
Construction
Supervisor/Estimator
1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00
HR Manager 1 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00
HR Administrative Assistant 1 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00
Financial Planning Analysts 1 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00
Direct Labor
Ticket Operator 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00
Train Driver 9 15,000.00 45,000.00 90,000.00 135,000.00 135,000.00 135,000.00
Indirect Labor
Security Guards 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00
Janitors/Janitress 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00
TOTAL 125 297,940.00 241,000.00 789,280.00 1,337,560.00 1,885,840.00 1,885,840.00 1,885,840.00
Table 1.3 Employee’s 13th
Month Pay
P a g e | 50

SALARY WITH DEDUCTIONS
Salary deductions are mandated fees collected by the government. These are deductions collected from the
employee's income and are used to give benefits and loans to employees. GRT Corporation will be participating in this
legal responsibilities to ensure the future of its employees.
 SSS or the Social Security System is one of the deductions in employee's income. The collected deduction from
employees is submitted to the Social Security system. The fees collected from the employees are accumulated,
and in time mandated by the government agency, loans are made available to members.
 Philhealth Contribution is another contribution collected from the employees. These contributions are intended for
the employee's health welfare. When emergency times come, Philhealth provides discounts and medical benefits
to help in employee's medical needs.
 Pag-ibig fund contribution is also deducted from employee's salary. In return, employees are given loan privileges
for housing purposes.
 Withholding Taxes Withholding taxes are individual taxes coming from each employee. These taxes are given to
the government. The percentage of deduction for each employee will be based on the individual's salary as well on
the number qualified dependents.
o Net pay of labors are the amount that retained in the salary of the workers after the deduction from SSS,
Philhealth, Pag-ibig, and Withholding Tax are made.
P a g e | 51
EMPLOYEES BASIC SALARY WITH DEDUCTIONS
POSITION
BASIC
SALARY
GROSS
PAY
DEDUCTIONS
NET PAY
SSS
CONTRIBUTIO
N
PHILHEALTH
CONTRIBUTIO
N
PAG-IBIG
CONTRIBUTIO
N
WITHOLDIN
G TAX
Administrative Labor
General Manager 40,000.00 40,000.00 581.30 437.50 800.00 8,331.03 29,850.17
Operations Engineer 33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67
Project Engineer 33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67
Assistant Engineer 23,000.00 23,000.00 581.30 287.50 460.00 3,424.55 18,246.65
Construction
Supervisor/Estimator
33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67
HR Manager 28,000.00 28,000.00 581.30 350.00 560.00 4,757.28 21,751.42
HR Administrative
Assistant
23,000.00 23,000.00 581.30 287.50 460.00 3,424.55 18,246.65
Financial Planning
Analysts
28,000.00 28,000.00 581.30 350.00 560.00 4,757.28 21,751.42
Direct Labor
Ticket Operator 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71
Train Driver 15,000.00 15,000.00 545.00 187.50 300.00 1,514.57 12,452.93
Indirect Labor
Security Guards 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71
Janitors/Janitress 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71
TOTAL
297,940.0
0
297,940.0
0
6,721.50 3,625.00 5,420.00 48,975.12
233,198.3
8
Table 2.1 Employee’s Basic Salary Deductions
P a g e | 52
EMPLOYEE'S SSS CONTRIBUTION
POSITION
EMPLOYEE
#
BASIC
SALARY
SSS MONTHLY
CONTRIBUTION
2015 2016 2017 2018 2019 2020
Administrative Labor
General Manager 1 40,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Operations Engineer 1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Project Engineer 1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Assistant Engineer 1 23,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Construction
Supervisor/Estimator
1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
HR Manager 1 28,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
HR Administrative Assistant 1 23,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Financial Planning Analysts 1 28,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60
Direct Labor
Ticket Operator 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40
Train Driver 9 15,000.00 545.00 19,620.00 39,240.00 58,860.00 58,860.00 235,440.00
Indirect Labor
Security Guards 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40
Janitors/Janitress 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40
TOTAL 125 297,940.00 55,804.80 295,183.20 534,561.60 773,940.00 773,940.00 950,520.00
Table 2.3 Employee’s SSS Contribution
P a g e | 53
EMPLOYER'S SSS CONTRIBUTION
POSITION
EMPLOYE
E #
BASIC
SALARY
SSS MONTHLY
CONTRIBUTIO
N
2015 2016 2017 2018 2019 2020
Administrative Labor
General Manager 1 40,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Operations Engineer 1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Project Engineer 1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Assistant Engineer 1 23,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Construction
Supervisor/Estimator
1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
HR Manager 1 28,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
HR Administrative
Assistant
1 23,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Financial Planning
Analysts
1 28,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40
Direct Labor
Ticket Operator 36 13,980.00 1,031.30
148,507.2
0
297,014.40 445,521.60 445,521.60 445,521.60
Train Driver 9 15,000.00 1,105.00 39,780.00 79,560.00 119,340.00 119,340.00 477,360.00
Indirect Labor
Security Guards 36 13,980.00 1,031.30
148,507.2
0
297,014.40 445,521.60 445,521.60 445,521.60
Janitors/Janitress 36 13,980.00 1,031.30
148,507.2
0
297,014.40 445,521.60 445,521.60 445,521.60
TOTAL 125
297,940.0
0
113,155.2
0
598,456.8
0
1,083,758.4
0
1,569,060.0
0
1,569,060.0
0
1,927,080.0
0
Table 2.4 Employer’s SSS Contribution
P a g e | 54

EMPLOYEE'S PHILHEALTH CONTRIBUTION
POSITION
EMPLOYEE
#
BASIC
SALARY
PHILHEALTH
MONTHLY
CONTRIBUTION
2015 2016 2017 2018 2019 2020
Administrative Labor
General Manager 1 40,000.00 437.50 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00
Operations Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
Project Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
Assistant Engineer 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00
Construction
Supervisor/Estimator
1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
HR Manager 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00
HR Administrative Assistant 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00
Financial Planning Analysts 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00
Direct Labor
Ticket Operator 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
Train Driver 9 15,000.00 187.50 6,750.00 13,500.00 20,250.00 20,250.00 81,000.00
Indirect Labor
Security Guards 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
Janitors/Janitress 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
TOTAL 125 297,940.00 35,400.00 112,350.00 189,300.00 266,250.00 266,250.00 327,000.00
Table 2.6 Employee’s PhilHealth Contribution
P a g e | 55

EMPLOYER'S PHILHEALTH CONTRIBUTION
POSITION
EMPLOYEE
#
BASIC
SALARY
PHILHEALTH
MONTHLY
CONTRIBUTION
2015 2015 2016 2017 2018 2019
Administrative Labor
General Manager 1 40,000.00 437.50 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00
Operations Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
Project Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
Assistant Engineer 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00
Construction
Supervisor/Estimator
1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00
HR Manager 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00
HR Administrative Assistant 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00
Financial Planning Analysts 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00
Direct Labor
Ticket Operator 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
Train Driver 9 15,000.00 187.50 6,750.00 13,500.00 20,250.00 20,250.00 81,000.00
Indirect Labor
Security Guards 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
Janitors/Janitress 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00
TOTAL 125 297,940.00 35,400.00 112,350.00 189,300.00 266,250.00 266,250.00 327,000.00
Table 2.6 Employer’s PhilHealth Contribution
P a g e | 56
EMPLOYEE'S PAG-IBIG CONTRIBUTION
POSITION
EMPLOYEE
#
BASIC
SALARY
PAG-IBIG
MONTHLY
CONTRIBUTION
2015 2015 2016 2017 2018 2019
Administrative Labor
General Manager 1 40,000.00 800.00 9,600.00 9,600.00 9,600.00 9,600.00 9,600.00 9,600.00
Operations Engineer 1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00
Project Engineer 1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00
Assistant Engineer 1 23,000.00 460.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00
Construction
Supervisor/Estimator
1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00
HR Manager 1 28,000.00 560.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00
HR Administrative Assistant 1 23,000.00 460.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00
Financial Planning Analysts 1 28,000.00 560.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00
Direct Labor
Ticket Operator 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00
Train Driver 9 15,000.00 300.00 10,800.00 21,600.00 32,400.00 32,400.00 129,600.00
Indirect Labor
Security Guards 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00
Janitors/Janitress 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00
TOTAL 125 297,940.00 57,840.00 111,840.00 165,840.00 219,840.00 219,840.00 317,040.00
Table 2.7 Employee’s PAG-IBIG Fund Contribution
P a g e | 57
EMPLOYEE'S WITHOLDING TAX
POSITION
EMPLOYE
E #
BASIC
SALARY
MONTHLY
WITHOLDIN
G TAX
2015 2016 2017 2018 2019 2020
Administrative Labor
General Manager 1 40,000.00 8,331.03 99,972.36 99,972.36 99,972.36 99,972.36 99,972.36 99,972.36
Operations Engineer 1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36
Project Engineer 1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36
Assistant Engineer 1 23,000.00 3,424.55 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60
Construction
Supervisor/Estimator
1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36
HR Manager 1 28,000.00 4,757.28 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36
HR Administrative
Assistant
1 23,000.00 3,424.55 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60
Financial Planning
Analysts
1 28,000.00 4,757.28 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36
Direct Labor
Ticket Operator 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88
Train Driver 9 15,000.00 1,514.57 54,524.52 109,049.04 163,573.56 163,573.56 654,294.24
Indirect Labor
Security Guards 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88
Janitors/Janitress 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88
TOTAL 125
297,940.0
0
520,923.3
6
1,158,686.7
6
1,796,450.1
6
2,434,213.5
6
2,434,213.5
6
2,924,934.2
4
Table 2.8 Employee’s Withholding Tax
P a g e | 58
REGULAR PAID HOLIDAY
Holiday Pay
Holiday pay refers to the payment of the regular daily wage for any unworked
regular holiday.Employees covered by the holiday pay rule are entitled to their basic
wage for any non-working regular holiday. Employees who would be working for the
said holiday will have a double pay.
Pursuant to the provisions of the Labor Code, as amended in relation to the
observance of declared holidays and in response to the queries received every time a
Presidential Proclamation or a law is enacted by Congress which declares certain
days either as a regular holiday, a special day or a special working holiday, the
following guidelines shall be observed by all employers in the private sector:
Unless otherwise modified by law, order, or proclamation, the following are the
twelve (12) regular holidays in a year under Executive Order No. 292, as amended by
Republic Act 9849:
o New Year’s Day - January 1
o Maundy Thursday - Movable Date
o Good Friday - Movable Date
o Araw ng Kagitingan - April 9
o Labor Day - May 1
o Independence Day - June 12
o National Heroes’ Day - Last Monday of August
o Bonifacio Day - November 30
o Eid’l Fitr - Movable Date
o Eid’l Adha - Movable Date
o Christmas Day - December 25
o Rizal Day - Monday nearest December 30
P a g e | 59
The following rules shall apply:
1. If it is an employee’s regular workday
o If unworked – 100%
o If worked:
 1st 8 hours – 200%
 excess of 8 hours – plus 30% of hourly rate on said day
2. If it is an employee’s rest day
o If unworked – 100%
o If worked
 1st 8 hours – plus 30% of 200%
 excess of 8 hours – plus 30% of hourly rate on said day
Premium Pay
Premium pay refers to the additional compensation for work performed within
eight (8) hours on non-work days, such as rest days and special days.
Unless otherwise modified by law, order, or proclamation, the following are the
three (3) special days in a year under Executive Order No. 292, as amended by
Republic Act 9849 that shall be observed in the Philippines:
o Ninoy Aquino Day - August 21
o All Saints Day - November 1
o Last Day of the Year - December 31
The following rules shall apply:
1. If unworked
o No pay, unless there is a favorable company policy, practice or
collective bargaining agreement (CBA) granting payment of wages on
special days even if unworked.
P a g e | 60
2. If worked
o 1st 8 hours – plus 30% of the daily rate of 100%
o excess of 8 hours – plus 30% of hourly rate on said day
o Falling on the employee’s rest day and if worked
o 1st 8 hours – plus 50% of the daily rate of 100%
o excess of 8 hours – plus 30% of hourly rate on said day
For those declared as special working holidays, the following rules shall apply:
o For work performed, an employee is entitled only to his basic rate. No
premium pay is required since work performed on said days is
considered work on ordinary working days.
Professional Fee
The company will have an On-Call CPA Consultant that will be paid PHP
8,000.00 quarterly.
PROFESSIONAL FEE FOR ON-CALL CPA CONSULTANT
2015 2016 2017 2018 2019
Annual Gross Pay 32,000.00 32,960.00 33,948.80 34,967.26 36,016.28
Withholding Tax 11,317.56 11,657.09 12,006.80 12,367.00 12,738.01
Annual Net Pay 20,682.44 21,302.91 21,942.00 22,600.26 23,278.27
Table 4.1 Professional Fee for On-Call CPA Consultant
The company will hire a Construction Supervisor/Estimator until the project
(rebuilding of Northrail transit which is from Tutuban, Manila to Dagupan, Pangasinan)
is complete which is projected to be done on 2018. He will be paid PHP 33,000.00
monthly.
P a g e | 61

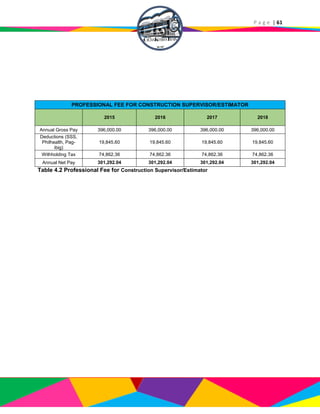

PROFESSIONAL FEE FOR CONSTRUCTION SUPERVISOR/ESTIMATOR
2015 2016 2017 2018
Annual Gross Pay 396,000.00 396,000.00 396,000.00 396,000.00
Deductions (SSS,
Philhealth, Pag-
ibig)
19,845.60 19,845.60 19,845.60 19,845.60
Withholding Tax 74,862.36 74,862.36 74,862.36 74,862.36
Annual Net Pay 301,292.04 301,292.04 301,292.04 301,292.04
Table 4.2 Professional Fee for Construction Supervisor/Estimator
P a g e | 62
BUSINESS TIMELINE
Prior to the actual business operation, it is part of the process to fulfill the necessary pre-operating requirements
and the responsibilities. In order to do this, the company recognized organizational structure from selection of business
supported with a feasibility study and the following company activities that will support the legality, manpower
requirements, safe and engineered facility, competitiveness and strong market impact of the company.
The proponents use Gantt chart to show the scheduling of company activities from selecting a business to be
established up to the normal start of operation.
P a g e | 63

BUSINESS TIMELINE
ACTIVITY
2015 2015
201
6
2017 2018
JULY AUGUST
SEPTEM
BER
OCTOBE
R
NOVEM
BER
DECEMBE
R
JANUARY
FEBRUA
RY
1 2 3 4 1 2 3 4 1 2 3 4 1 2 3 4
2014 -
2015
1
2015 -
2016
1
2017 -
2018
1 2 3 4
1 Selection of business.
2 Feasibility study of business.
3 Canvassing of office furniture,
supplies, and equipment.
4 Registration of business.
5 Purchasing of office furniture,
supplies, and equipment.
6 Hiring, orientation, and training of
business administration and
construction firm.
7 Reconstruction of establishment.
8 Start of operation.
9 Reconstruction of establishment.
8 Start of operation.
11 Reconstruction of establishment.
12 Regular operations.
P a g e | 64
MANAGEMENT ASSUMPTIONS
The following assumptions were made in order to compute the administrative
expenses:
 The proponents assume that there are 15 holidays in a year; 12 regular
holidays and 3 special holidays under Executive Order No. 292 as amended
by RA 9849.
 The proponents based the SSS contribution of the employees on the current
SSS Contribution table.
 The proponents based the PhilHealth contribution of employees on the
current PhilHealth Contribution Table.
 The proponents used the fixed P 100.00 HDMF Contribution for minimum
wage earner-employees only, and 2% rate of basic salary for others.
 The proponents assume that in a year, there will be 3 stations that are
built/finished and will be operational.
P a g e | 65
MARKETING ASPECT
P a g e | 66
Marketing Aspect
The marketing aspect of the feasibility aspect will consider the major nature of
business, service description, the marketplace and industrial analysis and the marketing
strategy. Demand and supply will be analyzed to know the target market shares.
Service Description
Gicha Ressha Train Company manages Manila – Dagupan railroad which cover
major towns: Bulacan, Pampanga, Tarlac and Pangasinan from Manila and vice versa.
Our train will provide own comfortable seats and own air-condition. Quality and
safety is guaranteed to the passengers in their whole trip. Upon entering the stations,
there will be reliable security guards roaming around and responsible to provide quality
customer service that they need. Ticket vending machines and ticket booths are
available to easy access magnetic card train ticket.
To further increase customer satisfaction, the company is assured that
passengers are at ease in traveling. Gicha Ressha Train (GRT) will strive to build a
loyal customer service by offering a great facility during waiting and during the ride from
Manila to Dagupan City.
Market Comparison
Buses will be the direct competitors of Manila – Dagupan Railroad base on
routes. Presently, they are the one providing transportation for passengers who to travel
to Northern Luzon.
P a g e | 67
Industry Analysis
Philippines’ railroad transportation can be considered as a developing mode of
transportation. Picture below shows (fig. 1) the growing phase of railroad transportation.
However, most of the routes are only in inter-city.

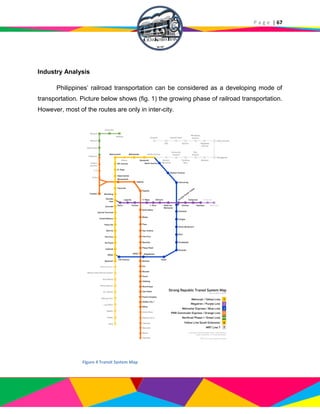

Figure 4 Transit System Map
P a g e | 68

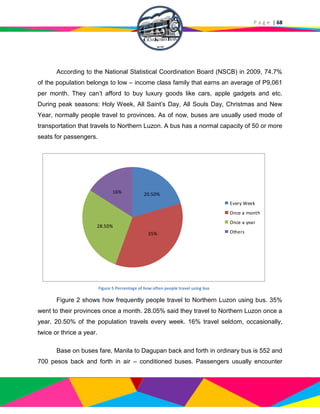

According to the National Statistical Coordination Board (NSCB) in 2009, 74.7%
of the population belongs to low – income class family that earns an average of P9,061
per month. They can’t afford to buy luxury goods like cars, apple gadgets and etc.
During peak seasons: Holy Week, All Saint’s Day, All Souls Day, Christmas and New
Year, normally people travel to provinces. As of now, buses are usually used mode of
transportation that travels to Northern Luzon. A bus has a normal capacity of 50 or more
seats for passengers.
Figure 2 shows how frequently people travel to Northern Luzon using bus. 35%
went to their provinces once a month. 28.05% said they travel to Northern Luzon once a
year. 20.50% of the population travels every week. 16% travel seldom, occasionally,
twice or thrice a year.
Base on buses fare, Manila to Dagupan back and forth in ordinary bus is 552 and
700 pesos back and forth in air – conditioned buses. Passengers usually encounter

20.50%
35%
28.50%
16%
Every Week
Once a month
Once a year
Others

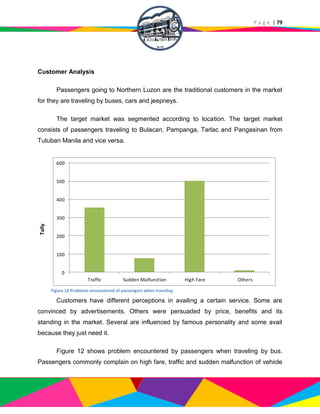

Figure 5 Percentage of how often people travel using bus
P a g e | 69
problems such as high fare, traffic, sudden malfunction, long waiting time, accidents and
long travel time.
Bus Travel Time
From To Distance
Time
Via
With Traffic No Traffic
Cubao Bocaue 26.1 km 2 hrs 1 hr 10min
Sapang
Palay-Sta
Cruz D.
Jose via Sta
Maria
Cubao Malolos 42.5 km 3 hrs 2h 34 min
Baclaran-
SM Fairview
via Quezon
Avenue and
Manila -
Banaue
Cubao
San
Fernando
80.3 km 3hrs 2h 5 min
Avenida -
Balanga
Cubao Angeles 92.8 km 3 hrs 2h 32 mins
Avenida -
Dau
Cubao Capas 118.3 km 3 hrs 2 hr 30 mins
Cubao -
Tarlac
Cubao Tarlac 131.5 km 4 hrs 3 hr 41 mins
Espana Blvd
- Candon
City and
Cubao Bayambang 179.9 km 6 hrs 5hr 41 mins
Avenida -
Baguio and
Aurora Blvd
- San Carlos
City
Cubao Dagupan 214 km 8 hrs 6hr 52 mins
Avenida –
Baguio
And
Cubao -
Dagupan
Table 1 Time Flow of Bus
P a g e | 70
Figure 6 Bus in the Philippines with 50 seats
Figure 7 Industrial Framework
P a g e | 71
Market Analysis
People using trains have shown steady growth. People traveling to Northern
Luzon are the one who will the company foresee to serve. The total target population is
881,651.
Location Population
Percentage of Willing to Ride
the train
Total
Tutuban 233,240 20.78% 183,240
Bocaue 86,994 5.69% 50,156
Malolos 112,375 10.48% 92,375
Capas 125,852 9.44% 83,211
Tarlac 143,600 14.70% 129,600
San
Fernando
150,762 10.86% 95,762
Angeles 208,268 11.03% 97,268
Bayambang 111,521 6.07% 53,497
Dagupan 163,676 10.95% 96,542
Total 1,336,288 100.00% 881,651
To determine the projected population for years 2015 – 2019, an average growth
rate of 1.90% was used. Table 15 shows the projected population for the next five
years.
Year Target Population
2015 898,402
2016 915,472
2017 932,866
2018 950,590
2019 968,652
Table 3 Projected Population
Bus companies are currently the available and serving the market. For now, they
have the ability of mass transportation going from Manila to Dagupan and vice versa.
Table 2 Total Population for the Year 2014
P a g e | 72
The proponents conducted a survey to 400 respondents that represent the total
population if the target market. Slovin’s Formula was used to determine the sample size
with 5% margin of error. For the computation of sample size, see appendices.
Demand Analysis
Figure 5 shows the mode of transportation used by passengers going to Northern
Luzon. The research shows 85.50% of the population used buses. 8.75% responded
that they travel using their private cars. 5.75% used jeepneys in going to Northern
Luzon.
8.75%
85.50%
5.75%
Cars
Buses
Jeepneys
Figure 8 Mode of Transportation going to Northern Luzon
P a g e | 73
Year
Target
Population
% of
Population
who are
willing to
ride train
Market
Acceptability
Potential
Target
Market
Percentage Frequency Annual Demand
Total Annual
DemandEvery
Week
Once a
month
Once a
year
Others Every Week
Once a
month
Once a
year
Others
2014 881,651 47.25% 71.25% 296,813.32 20.50% 35.00% 28.50% 16.00% 3,285,723.45 1,246,615.94 84,591.80 189,960.52 4,806,891.71
Table 4 Annual Demand for Manila - Dagupan Railroad Usag
P a g e | 74
Table 4 shows the demand for railroad transportation in the year 2014; the potential target market is calculated by
multiplying the target population to the percentage of population who are willing to use a train and market acceptability.
Annual demand is the product of potential target market, percentage of how people often use bus and number of days.
Finally, the total annual demand is obtained by adding all the annual demand for Manila – Dagupan Railroad usage.
Table 5 Projected Demand of Train Passengers
Year
Target
Population
% of
Population
who are
willing to
ride train
Market
Acceptability
Potential
Target
Market
Percentage Frequency Annual Demand
Total Annual
DemandEvery
Week
Once a
month
Once a
year
Others
Every Week
(54)
Once a month
(12)
Once a
year
(1)
Others
(4)
2015 898,402 47.25% 71.25% 302,452.77 20.50% 35.00% 28.50% 16.00% 3,348,152.19 1,270,301.64 86,199.04 193,569.77 4,898,222.65
2016 915,472 47.25% 71.25% 308,199.38 20.50% 35.00% 28.50% 16.00% 3,411,767.08 1,294,437.38 87,836.82 197,247.60 4,991,288.88
2017 932,866 47.25% 71.25% 314,055.16 20.50% 35.00% 28.50% 16.00% 3,476,590.66 1,319,031.69 89,505.72 200,995.30 5,086,123.37
2018 950,590 47.25% 71.25% 320,022.21 20.50% 35.00% 28.50% 16.00% 3,542,645.88 1,344,093.29 91,206.33 204,814.22 5,182,759.71
2019 968,652 47.25% 71.25% 326,102.63 20.50% 35.00% 28.50% 16.00% 3,609,956.15 1,369,631.06 92,939.25 208,705.69 5,281,232.15
P a g e | 75

Supply Analysis
Gicha Ressha Train Company is in the business in line with constructing railroad
system. Within the location for the stations chose by the proponents, bus transportation
services are the one that offer the same route as Manila – Dagupan line. On the other
hand, the proponent thought an improved mass transportation that can provide a
smooth ride.
Bus companies will be the direct competitor within the area that the business will
operate. These competitors are currently the provider of the said service. Supply is
important to fulfill the demand of the people.
Operating
Hours
No. of
authorized
Unit/s
No. of
passengers
per bus
Total no. of
Passengers
Annual
Supply
(365)
Bus 16 219 50 10,950 3,996,750
Total 3,996,750
Table 6 Competitor's Supply in 2014
Figure 9 Projected Demand for Train Usage
4,700,000.00
4,800,000.00
4,900,000.00
5,000,000.00
5,100,000.00
5,200,000.00
5,300,000.00
5,400,000.00
2015 2016 2017 2018 2019
P a g e | 76
Table 6 shows the annual competitor’s supply of buses in 2014. The proponents
conducted a time and motion study to several bus terminals to compute for the annual
supply. Result shows that total annual supply of buses for the year 2014 is 3,996,750.
Projecting supply is a way of forecasting sales. This enables the business to
decide on its production capacity and marketing strategies.
Year Supply
2015 4,196,588
2016 4,406,417
2017 4,626,738
2018 4,858,075
2019 5,100,978
Table 7 Projected Competitor's Supply 2015 – 2019
Figure 10 Projected Competitor's Supply
Supply
P a g e | 77
Demand – Supply Analysis
Demand Gap is equal to the number of potential customers less the supply of the
competitors. Computation for the demand gap stems from the competitors’ capacity to
supply the demand of the target market annually. Table 8, shows the computed demand
gap and its percentage for the year 2014.
Frequency Percentage
Demand Gap 810,142 16.85%
Competitors Supply 3,996,750 83.15%
Total Demand 4,806,891.71 100.00%
Table 8 Demand - Supply Gap 2014
16.85%
83.15%
Demand Gap
Bus
Figure 11 Percentage of Competitor's Supply and Demand Gap
The figure below shows the market share of GRT Company and competitor’s
supply including the demand gap for the year 2014. The pie chart below shows that the
demand gap is 16.85%
P a g e | 78
2015 2016 2017 2018 2019
Competitor's Supply 4196587.5 4406416.875 4626737.719 4858074.605 5100978.335
Total Demand 4,898,223 4,991,289 5,086,123 5,182,760 5,281,232
Store Capacity 867,716 921,948 976,180 1,030,412 1,084,644
Market Share 86% 88% 91% 94% 97%
Table 9 Market Share
The projected demand is greater than the projected supply throughout the study
time presentation. The market share of GRT Company is ascending which means that
the business is feasible but still, it must think through and improve marketing strategies
to satisfy demand.
Year Sale – VAT Inclusive Sale – Vat Exclusive
2015
105,208,564.82 93,936,218.59
2016
193,410,591.30 172,688,027.94
2017
628,729,822.81 561,365,913.22
2018
635,017,121.04 566,979,572.35
2019
641,367,292.25 572,649,368.08
Table 9 Computed Sale for five years of operation
P a g e | 79
Customer Analysis
Passengers going to Northern Luzon are the traditional customers in the market
for they are traveling by buses, cars and jeepneys.
The target market was segmented according to location. The target market
consists of passengers traveling to Bulacan, Pampanga, Tarlac and Pangasinan from
Tutuban Manila and vice versa.
Customers have different perceptions in availing a certain service. Some are
convinced by advertisements. Others were persuaded by price, benefits and its
standing in the market. Several are influenced by famous personality and some avail
because they just need it.
Figure 12 shows problem encountered by passengers when traveling by bus.
Passengers commonly complain on high fare, traffic and sudden malfunction of vehicle
0
100
200
300
400
500
600
Traffic Sudden Malfunction High Fare Others
Tally
Figure 12 Problems encountered of passengers when traveling
P a g e | 80
(bus). Others were bothered of long waiting time, difficult to find a bus when rush hour,
long traveling time and bus accidents.
Target Market Strategy
Quality and safety traveling are the priorities of our services. Since there is
already a railroad track from Tutuban to Dagupan, our primary target market will be the
passengers going from Manila to Bulacan, Pampanga, Tarlac and Pangasinan and vice
versa for leisure or business purposes.
Based on surveys, passengers encounter several problems when traveling like
traffic, sudden malfunction of vehicle, high fare, long waiting time, difficult to find a bus
when rush hour, long traveling time and bus accidents. These problems portray the
needs of the customers.
Gicha Ressha Train Company will endorse and maximize the best of our service
to every individual. It is our strategy to encourage our customers and for them to
patronize the service.
P a g e | 81

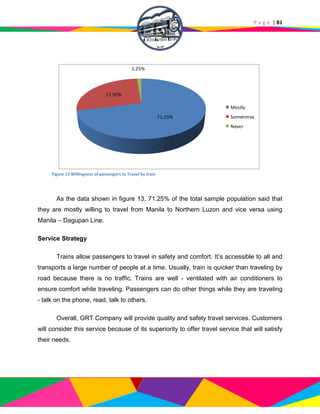

As the data shown in figure 13, 71.25% of the total sample population said that
they are mostly willing to travel from Manila to Northern Luzon and vice versa using
Manila – Dagupan Line.
Service Strategy
Trains allow passengers to travel in safety and comfort. It’s accessible to all and
transports a large number of people at a time. Usually, train is quicker than traveling by
road because there is no traffic. Trains are well - ventilated with air conditioners to
ensure comfort while traveling. Passengers can do other things while they are traveling
- talk on the phone, read, talk to others.
Overall, GRT Company will provide quality and safety travel services. Customers
will consider this service because of its superiority to offer travel service that will satisfy
their needs.
71.25%
27.50%
1.25%
Mostly
Sometimes
Never
Figure 13 Willingness of passengers to Travel by train

P a g e | 82
Pricing Strategy
Price is one of the most important factors that effects on the buying decision of
passengers. The table below shows the price of ticket.
Stations 2015 2016 2017 2018 2019
Tutuban to Bocaue 180 180 180 180 180
Tutuban to Malolos
Tutuban to San Fernando 230 230 230 230 230
Tutuban to Angeles
Tutuban to Capas
280 280 280 280 280
Tutuban to Tarlac
330 330 330 330 330
Tutuban to Bayambang
380 380 380 380 380
Tutuban to Dagupan
430 430 430 430 430
Table 10 Projected GRT Ticket Price for Five Years
P a g e | 83

Figure 14 Willingness to spend from Manila to first 4 stations
Figure 15 Willingness to spend from Manila to 5 - 8 stations
P a g e | 84

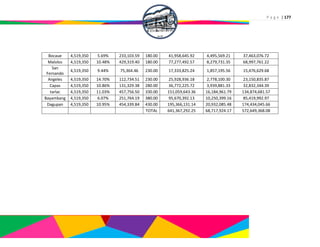

Figure 16 Willingness to spend from Manila to 9 - 12 stations
Figure 17 Willingness to spend from Manila to 13 - 16 stations
Figure 18 Willingness to spend from Manila to 17 to 20 stations
P a g e | 85

Figure 19 Willingness to spend from Manila to 21 - 24 stations
Figure 20 Willingness to spend from Manila to 25 -28 stations
Figures above shows the result of market research conducted to know the
market’s willingness to spend for our service.
Sales Strategy
GRT Company sales strategy emphases on generating profits and meeting
increased market share position to where we initially established our business.
P a g e | 86

Our sales strategy will be the opportunity to travel to provinces in without traffic.
Through this strategy, passengers will be encouraged to try our service.
Advertising and Promotion Strategy
Advertising and promotional communication are an important part of brand
marketing strategy. They are also a significant part of the cultural experience of millions
of consumers. GRT Company advertising strategy will be using government television
network.
Marketing and Sales
The sales of GRT Company are based on the survey result of acceptable sample
size representing the primary target market.
2015
Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 3,615,480 20.78% 751,432 - - - -
Bocaue 3,615,480 5.69% 205,680 180.00 37,022,407.59 3,966,686.53 33,055,721.07
Malolos 3,615,480 10.48% 378,812 180.00 68,186,157.22 7,305,659.70 60,880,497.52
TOTAL 105,208,564.82 11,272,346.23 93,936,218.59
2016
Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 3,615,480 20.78% 826,574.93 - - - -
Bocaue 3,615,480 5.69% 226,248.05 180.00 40,724,648.35 4,363,355.18 36,361,293.17
Malolos 3,615,480 10.48% 416,693.18 180.00 75,004,772.94 8,036,225.67 66,968,547.27
San
Fernando
3,615,480 9.44% 73,148 230.00 16,824,040.00 1,802,575.71 15,021,464.29
Angeles 3,615,480 14.70% 109,419 230.00 25,166,370.00 2,696,396.79 22,469,973.21
Capas 3,615,480 10.86% 127,467 280.00 35,690,760.00 3,824,010.00 31,866,750.00
TOTAL 193,410,591.30 20,722,563.35 172,688,027.94
P a g e | 87
2017
Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,067,415 20.78% 834,840.68 - - - -
Bocaue 4,067,415 5.69% 228,510.53 180.00 41,131,894.84 4,406,988.73 36,724,906.11
Malolos 4,067,415 10.48% 420,860.11 180.00 75,754,820.67 8,116,587.93 67,638,232.74
San
Fernando
4,067,415 9.44% 73,879.48 230.00 16,992,280.40 1,820,601.47 15,171,678.93
Angeles 4,067,415 14.70% 110,513.19 230.00 25,418,033.70 2,723,360.75 22,694,672.95
Capas 4,067,415 10.86% 128,741.67 280.00 36,047,667.60 3,862,250.10 32,185,417.50
tarlac 4,067,415 11.03% 448,737 330.00 148,083,171.61 15,866,054.10 132,217,117.51
Bayambang 4,067,415 6.07% 246,803 380.00 93,785,307.45 10,048,425.80 83,736,881.65
Dagupan 4,067,415 10.95% 445,388 430.00 191,516,646.54 20,519,640.70 170,997,005.84
TOTAL 628,729,822.81 67,363,909.59 561,365,913.22
2018
Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,293,383 20.78% 843,189.08 - - - -
Bocaue 4,293,383 5.69% 230,795.63 180.00 41,543,213.79 4,451,058.62 37,092,155.17
Malolos 4,293,383 10.48% 425,068.72 180.00 76,512,368.88 8,197,753.81 68,314,615.07
San
Fernando
4,293,383 9.44% 74,618.27 230.00 17,162,203.20 1,838,807.49 15,323,395.72
Angeles 4,293,383 14.70% 111,618.32 230.00 25,672,214.04 2,750,594.36 22,921,619.68
Capas 4,293,383 10.86% 130,029.09 280.00 36,408,144.28 3,900,872.60 32,507,271.68
tarlac 4,293,383 11.03% 453,224.25 330.00 149,564,003.33 16,024,714.64 133,539,288.68
Bayambang 4,293,383 6.07% 249,271.48 380.00 94,723,160.52 10,148,910.06 84,574,250.47
Dagupan 4,293,383 10.95% 449,841.43 430.00 193,431,813.01 20,724,837.11 172,706,975.90
TOTAL 635,017,121.04 68,037,548.68 566,979,572.35
P a g e | 88
2019
Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,519,350 20.78% 851,620.97 - - - -
Bocaue 4,519,350 5.69% 233,103.59 180.00 41,958,645.92 4,495,569.21 37,463,076.72
Malolos 4,519,350 10.48% 429,319.40 180.00 77,277,492.57 8,279,731.35 68,997,761.22
San
Fernando
4,519,350 9.44% 75,364.46 230.00 17,333,825.24 1,857,195.56 15,476,629.68
Angeles 4,519,350 14.70% 112,734.51 230.00 25,928,936.18 2,778,100.30 23,150,835.87
Capas 4,519,350 10.86% 131,329.38 280.00 36,772,225.72 3,939,881.33 32,832,344.39
tarlac 4,519,350 11.03% 457,756.50 330.00 151,059,643.36 16,184,961.79 134,874,681.57
Bayambang 4,519,350 6.07% 251,764.19 380.00 95,670,392.13 10,250,399.16 85,419,992.97
Dagupan 4,519,350 10.95% 454,339.84 430.00 195,366,131.14 20,932,085.48 174,434,045.66
TOTAL 641,367,292.25 68,717,924.17 572,649,368.08
Table 11 Computed Sales For the Year 2015
Year Sale – VAT Inclusive Sale – Vat Exclusive
2015
105,208,564.82 93,936,218.59
2016 193,410,591.30 172,688,027.94
2017
628,729,822.81 561,365,913.22
2018 635,017,121.04 566,979,572.35
2019 641,367,292.25 572,649,368.08
Table 12 Computed Sales for five years operation
P a g e | 89

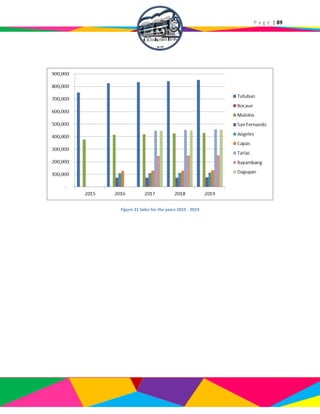

Figure 21 Sales for the years 2015 - 2019
P a g e | 90

TECHNICAL ASPECT
P a g e | 91
Technical Aspect
In this section shows the basic and operation flow of the business. Also the
technical principles and practices in the implementation of the project. Technical aspect
covers the materials, equipment, lay-out of the service, supplies of materials, structure
plan, location and expenses.
Technical aspect is one of the most important parts of the study because it
covers the technicality of the service in your business. It also covers the availability of all
the materials and properties of the business and it also requires that the location of the
business is near to the location of the operations and also to the customer.
Service Description
Railway transport is a kind of transportation that can carry people and goods that
the wheels are connected to the rails. It also called as train transport. Unlike vehicles
running on land, rail road vehicles are running directionally lead on the pathways that
are connected to the surface. Basically the tracks are steel rails that are installed in the
railroad tie and track ballast, on which the rolling stock with an installed metal wheels
moves.
Railroad transportation is one of the most convenient modes of transportation
today. Aside from being fast and cheap, it will cause you less time to go from one place
to another because there is no traffic ahead. Most of the people that are going to work
use this kind of transportation.
One of major concerns of passengers going to Northern provinces is high fare
because of the toll fees. Most people can’t afford to go to provinces especially the low –
income class family.
P a g e | 92
GRT Company is planning on reviving the railroad from Tutuban to Dagupan in
order to help the passengers to go to these provinces in a fast way with cheaper price.
The company aims to make the railroad more suitable to passengers especially to the
low - income class family and also to allow traveling of goods coming from these
provinces.
Location
Figure 22 GRT Company Office Location
P a g e | 93
Figure 23 Satellite View Map
Figure 24 Actual Site
P a g e | 94
The site is located at 3F Natividad Building T.M. Kalaw Street Ermita, Manila with
a measurement of 150 sqm. This business will be targeting the Manila - Dagupan
Railway that was closed since 1939. This area will include offices, conference rooms,
pantry, comfort rooms, lobby, elevators and parking space.
Route Map
Figure 25 Route Map Tutuban to Dagupan
P a g e | 95
On figure, this will be the route map of the railway from Tutuban (Manila) to
Dagupan (Pangasinan). It has a total distance of 214 km and has a travel time of 1 hour
and 46 mins.
Building and Facilities
There will be stations in Tutuban in Manila, Bocaue and Malolos in Bulacan, San
Fernando and Angeles in Pampanga, Capas and Tarlac City in Tarlac, and Bayambang
to Dagupan in Pangasinan.
Each stations consist of a manual type of ticket system and an automatic type of
ticket system. It also have a ticketing system for PWD (Persons with Disability). GRT
Company Office is located just 2.5 kilometers from the Tutuban station to easily monitor
the line. All the stations of Manila – Dagupan Line will have the same appearance of
building to easily recognize by the people.

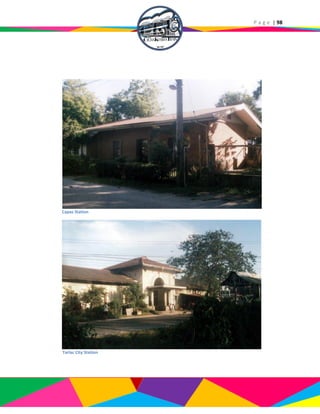

Tutuban Station
P a g e | 96
Malolos Station
Bocaue Station
P a g e | 97
San Fernando Station
Angeles Station
P a g e | 98
Capas Station
Tarlac City Station

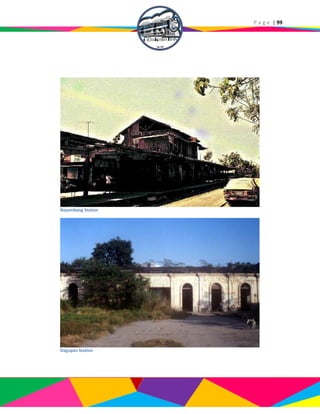

P a g e | 99
Bayambang Station
Dagupan Station
P a g e | 100

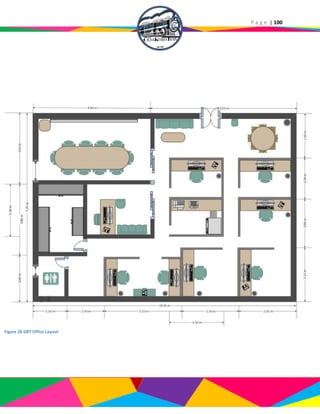

Figure 26 GRT Office Layout
P a g e | 101
Figure 27 Electrical Layout
P a g e | 102

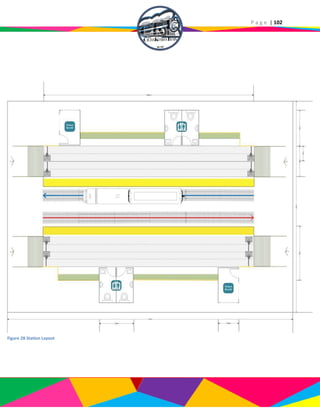

Figure 28 Station Layout
P a g e | 103

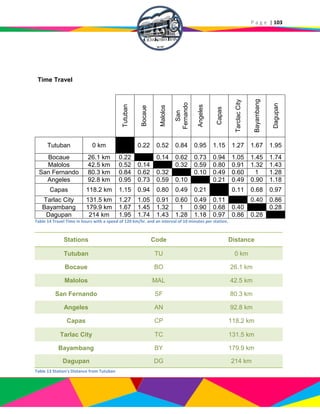

Time Travel
Tutuban
Bocaue
Malolos
San
Fernando
Angeles
Capas
TarclacCity
Bayambang
Dagupan
Tutuban 0 km 0.22 0.52 0.84 0.95 1.15 1.27 1.67 1.95
Bocaue 26.1 km 0.22 0.14 0.62 0.73 0.94 1.05 1.45 1.74
Malolos 42.5 km 0.52 0.14 0.32 0.59 0.80 0.91 1.32 1.43
San Fernando 80.3 km 0.84 0.62 0.32 0.10 0.49 0.60 1 1.28
Angeles 92.8 km 0.95 0.73 0.59 0.10 0.21 0.49 0.90 1.18
Capas 118.2 km 1.15 0.94 0.80 0.49 0.21 0.11 0.68 0.97
Tarlac City 131.5 km 1.27 1.05 0.91 0.60 0.49 0.11 0.40 0.86
Bayambang 179.9 km 1.67 1.45 1.32 1 0.90 0.68 0.40 0.28
Dagupan 214 km 1.95 1.74 1.43 1.28 1.18 0.97 0.86 0.28
Table 13 Station's Distance from Tutuban
Table 14 Travel Time in hours with a speed of 120 km/hr. and an interval of 10 minutes per station.
Stations Code Distance
Tutuban TU 0 km
Bocaue BO 26.1 km
Malolos MAL 42.5 km
San Fernando SF 80.3 km
Angeles AN 92.8 km
Capas CP 118.2 km
Tarlac City TC 131.5 km
Bayambang BY 179.9 km
Dagupan DG 214 km
P a g e | 104

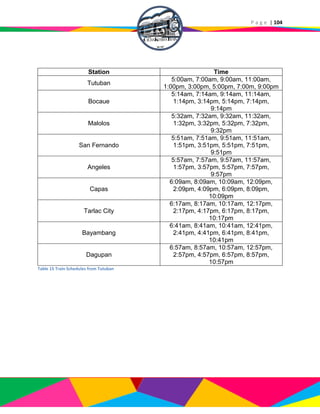

Station Time
Tutuban
5:00am, 7:00am, 9:00am, 11:00am,
1:00pm, 3:00pm, 5:00pm, 7:00m, 9:00pm
Bocaue
5:14am, 7:14am, 9:14am, 11:14am,
1:14pm, 3:14pm, 5:14pm, 7:14pm,
9:14pm
Malolos
5:32am, 7:32am, 9:32am, 11:32am,
1:32pm, 3:32pm, 5:32pm, 7:32pm,
9:32pm
San Fernando
5:51am, 7:51am, 9:51am, 11:51am,
1:51pm, 3:51pm, 5:51pm, 7:51pm,
9:51pm
Angeles
5:57am, 7:57am, 9:57am, 11:57am,
1:57pm, 3:57pm, 5:57pm, 7:57pm,
9:57pm
Capas
6:09am, 8:09am, 10:09am, 12:09pm,
2:09pm, 4:09pm, 6:09pm, 8:09pm,
10:09pm
Tarlac City
6:17am, 8:17am, 10:17am, 12:17pm,
2:17pm, 4:17pm, 6:17pm, 8:17pm,
10:17pm
Bayambang
6:41am, 8:41am, 10:41am, 12:41pm,
2:41pm, 4:41pm, 6:41pm, 8:41pm,
10:41pm
Dagupan
6:57am, 8:57am, 10:57am, 12:57pm,
2:57pm, 4:57pm, 6:57pm, 8:57pm,
10:57pm
Table 15 Train Schedules from Tutuban
P a g e | 105
Station Time
Dagupan
5:00am, 7:00am, 9:00am, 11:00am, 1:00pm,
3:00pm, 5:00pm, 7:00m, 9:00pm
Bayambang
5:17am, 7:17am, 9:17am, 11:17am, 1:17pm,
3:17pm, 5:17pm, 7:17pm, 9:17pm
Tarlac City
5:52am, 7:52am, 9:52am, 11:52am, 1:52pm,
3:52pm, 5:52pm, 7:52pm, 9:52pm
Capas
5:59am, 7:59am, 9:59am, 11:59am, 1:59pm,
3:59pm, 5:59pm, 7:59pm, 9:59pm
Angeles
6:11am, 8:11am, 10:11am, 12:11pm, 2:11pm,
4:11pm, 6:11pm, 8:11pm, 10:11pm
San Fernando
6:14am, 8:14am, 10:14am, 12:14pm, 2:14pm,
4:14pm, 6:14pm, 8:14pm, 10:14pm
Malolos
6:26am, 8:26am, 10:26am, 12:26pm, 2:26pm,
4:26pm, 6:26pm, 8:26pm, 10:26pm
Bocaue
6:45am, 8:45am, 10:45am, 12:45pm, 2:45pm,
4:45pm, 6:45pm, 8:45pm, 10:45pm
Tutuban
6:57am, 8:57am, 10:57am, 12:57pm, 2:57pm,
4:57pm, 6:57pm, 8:57pm, 10:57pm
Table 16 Train Schedules From Dagupan
P a g e | 106
Serving Process
The diagram below shows the Magnetic Card Ticket that customers will be using
is entering the premises in order to ride the train. This will be the key of entering and
exiting in the train. Stored value will worth 300 pesos good for 6 months, and the Single
Journey ticket will be good for only the day the customer buys it.
Figure 30 Stored Value Template
Figure 29 Single Journey Template
P a g e | 107
Process Average Distance Average Time Remarks
- - -
4 m 7 s -
- 5 s Money
5 m 8 s -
- 2 s Train Ticket
5 m 4 s -
Total 14 meters 26 seconds
Figure 31 Entering Station
The
passenger
will enter
the station
The passenger will go
to the ticket vendor
The passenger will
buy the ticket from the
ticket vendor
The passenger will go to
the automatic card
reader
The
passenger
will enter
the train
The passenger will
insert the ticket in the
automatic card reader

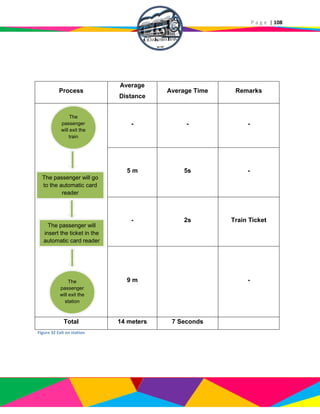

P a g e | 108
Process
Average
Distance
Average Time Remarks
- - -
5 m 5s -
- 2s Train Ticket
9 m -
Total 14 meters 7 Seconds
Figure 32 Exit on station
The
passenger
will exit the
train
The
passenger
will exit the
station
The passenger will
insert the ticket in the
automatic card reader
The passenger will go
to the automatic card
reader
P a g e | 109

Service
Year
2015 2016 2017 2018 2019
Train 3,615,480 3,615,480 4,067,415 4,293,383 4,519,350
Total 3,615,480 3,615,480 4,067,415 4,293,383 4,519,350
Figure 33 Store Capacity
Materials and Equipment
Materials and equipment serves an important role in the business in order to be
profitable and to be able to run in a long term. GRT Company believes that providing
the best service can satisfy the customers during on the station
P a g e | 110
Service Supplies (Direct Supplies)
Item Unit Cost
Quantity/Sup
plier
Total Cost
Life
span
Depreciation Cost
1. Train
1 pc 153,750,875
9/ Japan
Railway
System
307,501,750
50
years
28,395,157.5
2. Railway
1 km 34,400,000
214/ Japan
Railway
System
7,361,600,000
50
years
147,232,000
3. Clock
1 pc 295
18/ Western
Digital
5,310 5 years 1,062
4. Automatic Card
Reader
1 pcs 150,000 72/ 10,800,000
15
years
720,000
5. Magnetic Card Ticket
1 pc 45.15
900,000/ Shen
zhen
Chuangxinjia
RFID Tag Co.,
Ltd.
40,635,000
P a g e | 111
6. CCTV Camera
1
Pack
age
1,180
10/ CDR
King
11,800
5
years
5 years
TOTAL
8,756,205,665 175,636,715.50
Item Unit Unit Cost
Quantity
(Annual)/
Supplier
Total Cost Life Span Depreciation Cost
1. Computer Set
1 Set 4,500
8/ Pc Gilmore
Computer
Center
36,000 5 years
7200.00
2. 3 in 1 Printer
1 Unit 2,000
2/ Pc Gilmore
Computer
Center
4,000 5 years 800.00
3. Aircon
1 Unit 12,000
3/ Pc Gilmore
Computer
Center
36,000 10 years 3,600
4. Fax Machine
1 Unit 5,800 1/villman 5,800 5 years 1160
P a g e | 112
Item Unit Unit Cost
Quantity
(Annual)/
Supplier
Total Cost Life Span Depreciation Cost
5.Water Dispenser
1 unit 4,798
1/
Abenson
4,798 5 years 959.6
6.Refrigerator
1 unit 7,695 1/ Lazada 7,695 10 years 769.50
7. CCTV Camera
1
Pack
age
1,180
10/ CDR
King
11,800 5 years 2360.00
8. Microwave Oven
1 unit 3,368 1/Abenson 3,368 5 years 673.6
Total 109,461.00 17,522.70
Figure 34 Office Equipment
P a g e | 113
Item Unit Unit Cost
Quantity
(Annual)/
Supply
Total
cost

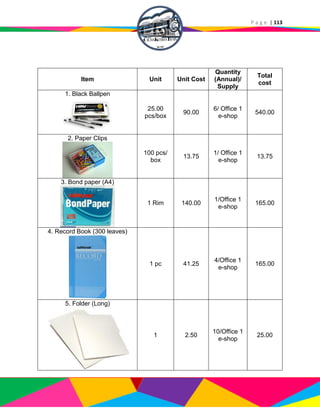

1. Black Ballpen
25.00
pcs/box
90.00
6/ Office 1
e-shop
540.00
2. Paper Clips
100 pcs/
box
13.75
1/ Office 1
e-shop
13.75
3. Bond paper (A4)
1 Rim 140.00
1/Office 1
e-shop
165.00
4. Record Book (300 leaves)
1 pc 41.25
4/Office 1
e-shop
165.00
5. Folder (Long)
1 2.50
10/Office 1
e-shop
25.00
P a g e | 114
Item Unit Unit Cost
Quantity
(Annual)/
Supply
Total
cost
6. Marker
12 pcs/box 96.00
1/ Office 1
e-shop
96.00
7. Stapler
1 pc 45.00
2/ Office 1
e-shop
90.00
8. Staple wire
1 box 4.83
4/ Office 1
e-shop
19.32
9. Staple Remover
1 pc 12.00
2/ Office 1
e-shop
24.00
P a g e | 115
Item Unit Unit Cost
Quantity
(Annual)/
Supply
Total
cost
10. Journal
4 books/
set
400.00
1/Office 1
e-shop
400.00
11. Ink for Printer
1 set
1,200.00
1/ Office 1
e-shop
1,200.00
12. Paper roll
1 roll 8.75
80/ Office 1
e-shop
700.00
Total 3413.07 Total 3413.07 Total
Figure 35 Office Supplies
P a g e | 116
Item Unit
Unit
Cost
Quantity
(Annual)/Supply
Total
Cost
Life
span
Depreciation
Cost
1. Office Desk
1 2,500
7/ ADB Office
Furniture
17,50
0
5
years
3,500.00
2. Office Chair

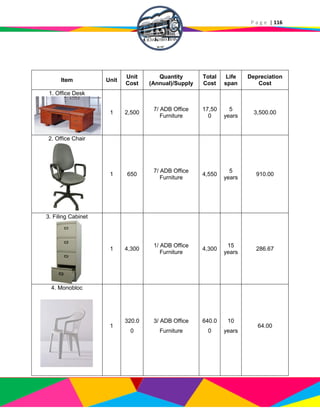

1 650
7/ ADB Office
Furniture
4,550
5
years
910.00
3. Filing Cabinet
1 4,300
1/ ADB Office
Furniture
4,300
15
years
286.67
4. Monobloc
1
320.0
0
3/ ADB Office
Furniture
640.0
0
10
years
64.00
P a g e | 117
Item Unit
Unit
Cost
Quantity
(Annual)/Supply
Total
Cost
Life
span
Depreciation
Cost
5. Fire Extinguisher
1 7,800
3/ ADB Office
Furniture
23,40
0
10
years
2,340.00
6. Storage Cabinet
1 1,999
6/ ADB Office
Furniture
11,99
4
10
years
1,199.40
Total 62,384 8,300.07
Figure 36 Office Furniture
P a g e | 118
Item Unit
Unit
Cost
Quantity
(Annual)/Supplier
Total
Cost
Life
Span
Depreciati
on Cost

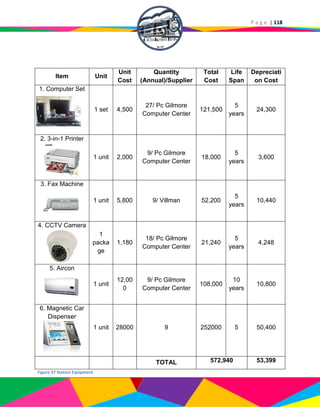

1. Computer Set
1 set 4,500
27/ Pc Gilmore
Computer Center
121,500
5
years
24,300
2. 3-in-1 Printer
1 unit 2,000
9/ Pc Gilmore
Computer Center
18,000
5
years
3,600
3. Fax Machine
1 unit 5,800 9/ Villman 52,200
5
years
10,440
4. CCTV Camera
1
packa
ge
1,180
18/ Pc Gilmore
Computer Center
21,240
5
years
4,248
5. Aircon
1 unit
12,00
0
9/ Pc Gilmore
Computer Center
108,000
10
years
10,800
6. Magnetic Car
Dispenser
1 unit 28000 9 252000 5 50,400
TOTAL 572,940 53,399
Figure 37 Station Equipment
P a g e | 119
Items Unit Unit Cost
Quantity(Annual)/Sup
plier
Total Cost
1. Black Ballpen
25 pcs/box 90
54/ Office 1
e-shop
4,860
2. Paper Clips
100pcs/box 13.75
9/ Office 1
e-shop
123.75
3. Bond paper (A4)
1 rim 140
9/ Office 1
e-shop
1260
4. Record Book (300 leaves)
1pc 41.25
36/ Office 1
e-shop
1485
5. Folder (Long)
1 2.5
90/ Office 1
e-shop
225
6. Marker
12pcs/box 96 9 864
P a g e | 120
7. Stapler
1 pc 45
18/ Office 1
e-shop
810
8. Staple wire
1 box 4.83
36/ Office 1
e-shop
173.88
9. Staple Remover
1 pc 12
18/ Office 1
e-shop
2,16
10. Journal
4 books/set 400
9/ Office 1
e-shop
3,600
11. Ink for Printer
1 set 1200
9/ Office 1
e-shop
10,800
12. Paper roll
1 roll 8.75 720 6,300
TOTAL 30717.63
Figure 38 Station Supplies
P a g e | 121
Items Unit
Unit
Cost
Quantity/Suppli
er
Total
Cost
Life
span
Depreciation
Cost
1. Office Desk
1 2500
9/ ADB Office
Furniture
22500
5
years
4,500
2. Office Chair
1 650
9/ ADB Office
Furniture
5850
5
yeas
1,170
3. Filing Cabinet
1 4300
9/ ADB Office
Furniture
38700
15
years
2,580
4. Monobloc
1 320
27/ ADB
Office
Furniture
8640
10
years
864
P a g e | 122
Items Unit
Unit
Cost
Quantity
Total
Cost
Life
span
Depreciation
Cost
5. Fire Extinguisher
1 7800
27/ ADB
Office
Furniture
210600
10
years
21,060
6. Storage Cabinet
1 19900
9/ ADB
Office
Furniture
179100
10
years
17,910

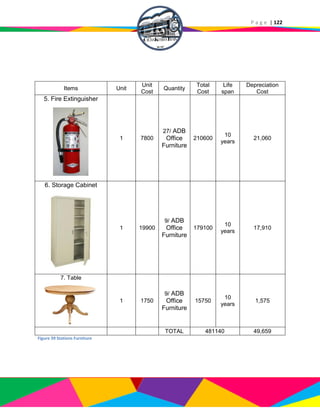

7. Table
1 1750
9/ ADB
Office
Furniture
15750
10
years
1,575
TOTAL 481140 49,659
Figure 39 Stations Furniture
P a g e | 123
Item Unit Cost
Quantity/
Supplier
Total
Cost
Life span
Deprecia
tion Cost

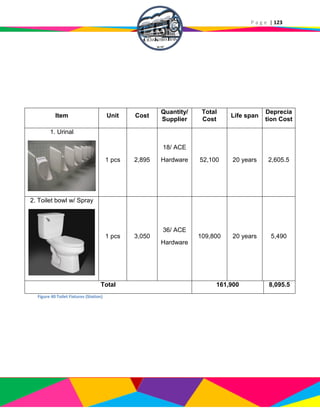

1. Urinal
1 pcs 2,895
18/ ACE
Hardware 52,100 20 years 2,605.5
2. Toilet bowl w/ Spray
1 pcs 3,050
36/ ACE
Hardware
109,800 20 years 5,490
Total 161,900 8,095.5
Figure 40 Toilet Fixtures (Station)
P a g e | 124
Items Unit
Cost/
Unit
Quantity Total Cost
1. Air Freshener
1 piece 140 36 5,040
2. Broom
1 piece 120 18 2,160
3. Stick broom
1 piece 10 9 90
4. Dust pan
1 piece 80 18 1,440
5. Floor Mop
1 piece 180 9 1,620
P a g e | 125
Items Unit
Cost/
Unit
Quantity Total Cost
6. Garbage Bags
1 roll 10 225 2,250
7. Garbage Cans
1 piece 100 18 1,800
8. Liquid Soap (Exel)
1 bottle 60 90 5,400
9. Hand Wash
1 bottle 35 36 1,260
10. Toilet Paper
1 roll 10 450 4,500
TOTAL 25,560
Figure 41 Janitorial and Comfort Room Supplies and Expenses
P a g e | 126
Utilities Expense
Water

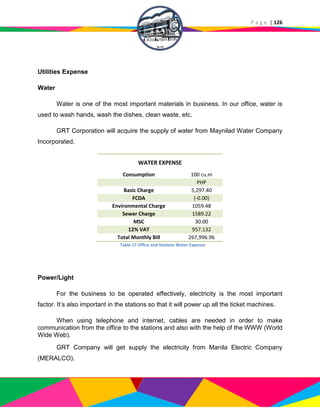

Water is one of the most important materials in business. In our office, water is
used to wash hands, wash the dishes, clean waste, etc.
GRT Corporation will acquire the supply of water from Maynilad Water Company
Incorporated.
WATER EXPENSE
Consumption 100 cu.m
PHP
Basic Charge 5,297.40
FCDA (-0.00)
Environmental Charge 1059.48
Sewer Charge 1589.22
MSC 30.00
12% VAT 957.132
Total Monthly Bill 267,996.96
Power/Light
For the business to be operated effectively, electricity is the most important
factor. It’s also important in the stations so that it will power up all the ticket machines.
When using telephone and internet, cables are needed in order to make
communication from the office to the stations and also with the help of the WWW (World
Wide Web).
GRT Company will get supply the electricity from Manila Electric Company
(MERALCO).
Table 17 Office and Stations Water Expense
P a g e | 127

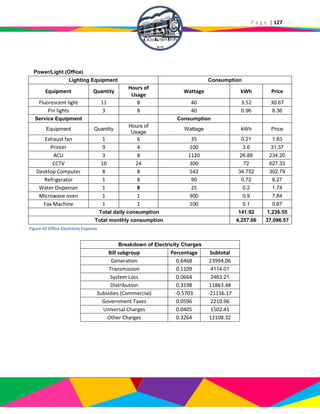

Power/Light (Office)
Lighting Equipment Consumption
Equipment Quantity
Hours of
Usage
Wattage kWh Price
Fluorescent light 11 8 40 3.52 30.67
Pin lights 3 8 40 0.96 8.36
Service Equipment Consumption
Equipment Quantity
Hours of
Usage
Wattage kWh Price
Exhaust fan 1 6 35 0.21 1.83
Printer 9 4 100 3.6 31.37
ACU 3 8 1120 26.88 234.20
CCTV 10 24 300 72 627.33
Desktop Computer 8 8 543 34.752 302.79
Refrigerator 1 8 90 0.72 6.27
Water Dispenser 1 8 25 0.2 1.74
Microwave oven 1 1 900 0.9 7.84
Fax Machine 1 1 100 0.1 0.87
Total daily consumption 141.92 1,236.55
Total monthly consumption 4,257.66 37,096.57
Breakdown of Electricity Charges
Bill subgroup Percentage Subtotal
Generation 0.6468 23994.06
Transmission 0.1109 4114.01
System Loss 0.0664 2463.21
Distribution 0.3198 11863.48
Subsidies (Commercial) -0.5703 -21156.17
Government Taxes 0.0596 2210.96
Universal Charges 0.0405 1502.41
Other Charges 0.3264 12108.32
Figure 42 Office Electricity Expense
P a g e | 128

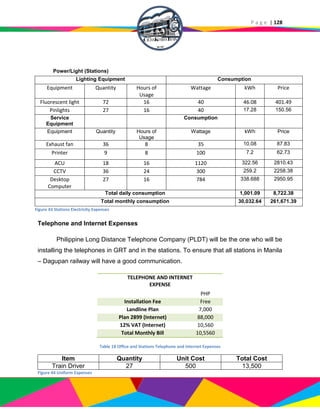

Power/Light (Stations)
Lighting Equipment Consumption
Equipment Quantity Hours of
Usage
Wattage kWh Price
Fluorescent light 72 16 40 46.08 401.49
Pinlights 27 16 40 17.28 150.56
Service
Equipment
Consumption
Equipment Quantity Hours of
Usage
Wattage kWh Price
Exhaust fan 36 8 35 10.08 87.83
Printer 9 8 100 7.2 62.73
ACU 18 16 1120 322.56 2810.43
CCTV 36 24 300 259.2 2258.38
Desktop
Computer
27 16 784 338.688 2950.95
Total daily consumption 1,001.09 8,722.38
Total monthly consumption 30,032.64 261,671.39
Telephone and Internet Expenses
Philippine Long Distance Telephone Company (PLDT) will be the one who will be
installing the telephones in GRT and in the stations. To ensure that all stations in Manila
– Dagupan railway will have a good communication.
TELEPHONE AND INTERNET
EXPENSE
PHP
Installation Fee Free
Landline Plan 7,000
Plan 2899 (Internet) 88,000
12% VAT (Internet) 10,560
Total Monthly Bill 10,5560
Table 18 Office and Stations Telephone and Internet Expenses
Item Quantity Unit Cost Total Cost
Train Driver 27 500 13,500
Figure 44 Uniform Expenses
Figure 43 Stations Electricity Expenses
P a g e | 129
Figure 45 Uniform Design
Rent Expense (Office)
Gicha Ressha Train will be renting a 90 sqm office space located at Natividad
Building T.M. Kalaw Street, Ermita Manila.
Cost
Rent Cost (512 per sqm) 46,170
Renovation 192,000
Total 238,170
P a g e | 130
Gas Expense
Gas expense will be use to make the train (Kogane) work.
2014
Liter
Price per
Liter
Total
379 44.16 16,736.64 33473.28
Total per month 401,679.4
ANNUAL GAS EXPENSE
2015 2016 2017 2018 2019 2020
409,712.9 417,907.2 426,265.4 434,790.7 443,486.5 452,356.2
*Note: 379L is good for 15 days
P a g e | 131
Land Expense
Location Total Land Area (sqm) Price per sqm (Php) Price (Php)
Tutuban 2753 2,654 7,306,462
Bocaue 1576 2,589 4,080,264
Malolos 2536 3,532 8,957,152
Capas 2021 2,587 5,228,327
Tarlac 2092 2,896 6,058,432
San Dernando 1214 2,764 3,355,496
Angeles 2990 2,365 7,071,350
Bayambang 2261 3,032 6,855,352
Dagupan 2492 3,582 8,926,344
Total 57,839,179
Building Cost Per Station Cost
Construction Permit Cost 4,796,272.4
Net Construction Cost 15,277,352
Total Electrical Material Cost 807,690
Total Plumbing Material Cost 1,200,000+
Total Building Cost Per Station PHP 22,144,314.4
Total Building Cost PHP 199,298,830
Permits and Licenses Cost
Securities and Exchange Commission 10,999.26
Department of Trade and Industry 4,500.00
Bureau of Internal Revenue 4,770.00
Business Permit
Business tax 112,500.00
Mayor’s Permit 1,800.00
Sanitary Inspection Fee 3,600.00
Garbage fee 11,700.00
Zoning Clearance 4,905.00
Signage fee 450.00
Business Plate 4,500.00
Barangay Clearance 4,500.00
Total 164,224.26
P a g e | 132
Waste Disposal Method
All stations from Manila to Dagupan are responsible to the health of people and
the same time the condition of the environment to their respective locations.
GRT will provide trash bin in every stations to secure that we maintain the good
atmosphere and at the same time we will assure you that we place it at the right place.
Before opening the station to passengers, garbage will be collected the day before by
the respective garbage collector. We also prepare a segregation scheme in order to
separate the biodegradable and non-biodegradable trash.
Re-using of scratch paper that can help reduce supplies cost of the company as
well as helping save trees.
P a g e | 133
Technical Assumptions
 The proponents assume that there is 2% increase in Office Supplies expense
every year.
 The proponents assume that there is 2% increase in Rental Expense every year.
 The proponents assume that there is 5% increase in Water Expense every year.
 The proponents assume that there is 5% increase in Power/Light Expense every
year.
 The proponents assume that there is 2% increase in Permits and Licenses every
year.
 The proponents assume that there is 2% increase in Gas Expense every year.
P a g e | 134
FINANCIAL ASPECT
P a g e | 135
CAPITAL
Pre-Operating Expenses
Permits and Licenses P 164,224
Service Equipments 8,792,163,185
Station Equipments 572,940
Office Equipments 106,093
Station Furnitures and Fixtures 481,140
Office Furniture and Fixtures 224,614
Supplies 18,168
Building 199,298,830
Land 57,839,179
Uniform 13,500
Salaries 1,374,461
Cash on Hand 7,743,666
TOTAL PROJECT COST P 9,060,000,000
Partner's Contribution 3,020,000,000.00
Table 19 Project Cost

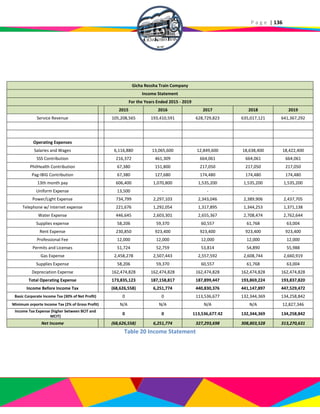

P a g e | 136
Gicha Ressha Train Company
Income Statement
For the Years Ended 2015 - 2019
2015 2016 2017 2018 2019
Service Revenue 105,208,565 193,410,591 628,729,823 635,017,121 641,367,292
Operating Expenses
Salaries and Wages 6,116,880 13,065,600 12,849,600 18,638,400 18,422,400
SSS Contribution 216,372 461,309 664,061 664,061 664,061
PhilHealth Contribution 67,380 151,800 217,050 217,050 217,050
Pag-IBIG Contribution 67,380 127,680 174,480 174,480 174,480
13th month pay 606,400 1,070,800 1,535,200 1,535,200 1,535,200
Uniform Expense 13,500 - - - -
Power/Light Expense 734,799 2,297,103 2,343,046 2,389,906 2,437,705
Telephone w/ Internet expense 221,676 1,292,054 1,317,895 1,344,253 1,371,138
Water Expense 446,645 2,603,301 2,655,367 2,708,474 2,762,644
Supplies expense 58,206 59,370 60,557 61,768 63,004
Rent Expense 230,850 923,400 923,400 923,400 923,400
Professional Fee 12,000 12,000 12,000 12,000 12,000
Permits and Licenses 51,724 52,759 53,814 54,890 55,988
Gas Expense 2,458,278 2,507,443 2,557,592 2,608,744 2,660,919
Supplies Expense 58,206 59,370 60,557 61,768 63,004
Depreciation Expense 162,474,828 162,474,828 162,474,828 162,474,828 162,474,828
Total Operating Expense 173,835,123 187,158,817 187,899,447 193,869,224 193,837,820
Income Before Income Tax (68,626,558) 6,251,774 440,830,376 441,147,897 447,529,472
Basic Corporate Income Tax (30% of Net Profit) 0 0 113,536,677 132,344,369 134,258,842
Minimum orporte Income Tax (2% of Gross Profit) N/A N/A N/A N/A 12,827,346
Income Tax Expense (higher between BCIT and
MCIT)
0 0 113,536,677.42 132,344,369 134,258,842
Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631
Table 20 Income Statement
P a g e | 137
Gicha Ressha Train Company
Statement of Changes in Equity
For the Years Ended 2015 - 2019
2015 2016 2017 2018 2019
Bacoy, Christian O. 3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814
Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544
Withdrawals - (400,000) (400,000) (400,000) (400,000)
Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
Balisi, Danica C. 3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814
Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544
Withdrawals - (400,000) (400,000) (400,000) (400,000)
Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
Rubico, Jonathan Ray
DL.
3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814
Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544
Withdrawals - (400,000) (400,000) (400,000) (400,000)
Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
Total Owner's Equity 8,991,373,442 8,996,425,216 9,322,518,914 9,630,122,442 9,942,193,073
Table 21 Statement of Changes in Owner's Equity
P a g e | 138
Gicha Ressha Train Company
Statement of Cash Flows
For the Years Ended 2015 - 2019
2015 2016 2017 2018 2019
Cash Flows from Operating Activities
Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631
Depreciation Expense 162,474,828 162,474,828 162,474,828 162,474,828 162,474,828
Increase (Decrease) in Gas 13,674,405 14,209,173 273,296,534 (75,104,137) (127,194,490)
Increase (Decrease) in Income Tax Payable - - (113,536,677) (18,807,692) (1,914,473)
Increase (Decrease) in Salaries Payable (510,237) (1,414,661) (394,187) - -
Increase (Decrease) in SSS Payable (21,546) (16,896) (16,896) - -
Increase (Decrease) in PAG-iBIG Payable (6,740) (3,900) (3,900) - -
Increase (Decrease) in Philhealth Payable (7,213) (5,438) (5,438) - -
Increase (Decrease) in Withholding Tax Payable - Salaries (616,010) 511,367 (43,980) - -
Increase (Decrease) in Power/Lighting Payable (149,515) (1,562,304) (45,942) (46,861) (47,798)
Increase (Decrease) in Water Payable (446,645) (2,156,656) (52,066) (53,107) (54,169)
Increase (Decrease) in Rent Payable (230,850) (692,550) - - -
Increase (Decrease) in Telephone w/ Internet (221,676) (1,070,378) (25,841) (53,107) (26,885)
Income Tax Paid - - - 113,536,677 132,344,369
Net Cash from Operating Activities 105,312,243 176,524,358 648,940,134 490,750,128 478,852,013
Cash Flows from Investing Activities
Building 199,298,830 - - - -
Land 57,839,179
Renovation 150,000
P a g e | 139
Office Equipment 106,093 - - - -
Office Furniture and Fixtures 224,614 - - - -
Station Equipments 481,140 - - - -
Service Equipment 8,792,163,185 - - - -
Station Furnitures and Fixtures 481,140 - - - -
Supplies 58,206 1,164 1,187 1,211 1,235
Net Cash from Investing Activities (9,050,802,386) (1,164) (1,187) (1,211) (1,235)
Cash Flows from Financing Activities
Owner's Investment - - - - -
Withdrawals - (1,200,000) (1,200,000) (1,200,000) (1,200,000)
Net Cash from Financing Activities - (1,200,000) (1,200,000) (1,200,000) (1,200,000)
Net Cash Increase (Decrease) (8,945,490,144) 175,323,194 647,738,946 489,548,917 477,650,777
Cash Beginning 9,060,000,000 114,509,856 289,833,050 937,571,996 1,427,120,913
Cash Ending 114,509,856 289,833,050 937,571,996 1,427,120,913 1,904,771,691
Table 22 Statement of Cash Flow
P a g e | 140

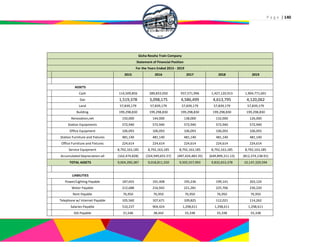

Gicha Ressha Train Company
Statement of Financial Position
For the Years Ended 2015 - 2019
2015 2016 2017 2018 2019
ASSETS
Cash 114,509,856 289,833,050 937,571,996 1,427,120,913 1,904,771,691
Gas 1,519,378 3,098,175 4,586,499 4,613,795 4,120,062
Land 57,839,179 57,839,179 57,839,179 57,839,179 57,839,179
Building 199,298,830 199,298,830 199,298,830 199,298,830 199,298,830
Renovation,net 150,000 144,000 138,000 132,000 126,000
Station Equipments 572,940 572,940 572,940 572,940 572,940
Office Equipment 106,093 106,093 106,093 106,093 106,093
Station Furniture and Fixtures 481,140 481,140 481,140 481,140 481,140
Office Furniture and Fixtures 224,614 224,614 224,614 224,614 224,614
Service Equipment 8,792,163,185 8,792,163,185 8,792,163,185 8,792,163,185 8,792,163,185
Accumulated Depreciation-all (162,474,828) (324,949,655.57) (487,424,483.35) (649,899,311.13) (812,374,138.91)
TOTAL ASSETS 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594

LIABILITIES
Power/Lighting Payable 187,655 191,408 195,236 199,141 203,124
Water Payable 212,688 216,942 221,281 225,706 230,220
Rent Payable 76,950 76,950 76,950 76,950 76,950
Telephone w/ Internet Payable 105,560 107,671 109,825 112,021 114,262
Salaries Payable 510,237 904,424 1,298,611 1,298,611 1,298,611
SSS Payable 21,546 38,442 55,338 55,338 55,338
P a g e | 141
Phil Health payable 7,213 12,650 18,088 18,088 18,088
Pag-IBIG Payable 6,740 10,640 14,540 14,540 14,540
Income Tax Payable - - 113,536,677 132,344,369 134,258,842
Withholding Tax Payable - Salaries 616,010 104,643 148,623 148,623 148,623
VAT Payable 11,272,346 20,722,563 67,363,910 68,037,549 68,717,924
TOTAL LIABILITIES 13,016,946 22,386,334 183,039,079 202,530,936 205,136,522
OWNER'S EQUITY
BACOY, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
BALISI, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
RUBICO, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358
TOTAL OWNER's EQUITY 8,991,373,442 8,996,425,216 9,322,518,914 9,630,122,442 9,942,193,073
TOTAL LIABILITIES AND OWNER'S
EQUITY
9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594
Table 23 Statement of Financial Position
P a g e | 142

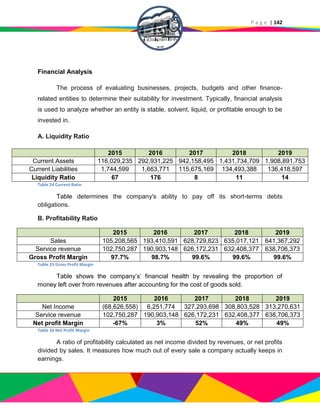

Financial Analysis
The process of evaluating businesses, projects, budgets and other finance-
related entities to determine their suitability for investment. Typically, financial analysis
is used to analyze whether an entity is stable, solvent, liquid, or profitable enough to be
invested in.
A. Liquidity Ratio
2015 2016 2017 2018 2019
Current Assets 116,029,235 292,931,225 942,158,495 1,431,734,709 1,908,891,753
Current Liabilities 1,744,599 1,663,771 115,675,169 134,493,388 136,418,597
Liquidity Ratio 67 176 8 11 14
Table 24 Current Ratio
Table determines the company's ability to pay off its short-terms debts
obligations.
B. Profitability Ratio
2015 2016 2017 2018 2019
Sales 105,208,565 193,410,591 628,729,823 635,017,121 641,367,292
Service revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373
Gross Profit Margin 97.7% 98.7% 99.6% 99.6% 99.6%
Table 25 Gross Profit Margin
Table shows the company’s’ financial health by revealing the proportion of
money left over from revenues after accounting for the cost of goods sold.
2015 2016 2017 2018 2019
Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631
Service revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373
Net profit Margin -67% 3% 52% 49% 49%
Table 26 Net Profit Margin
A ratio of profitability calculated as net income divided by revenues, or net profits
divided by sales. It measures how much out of every sale a company actually keeps in
earnings.
P a g e | 143
2015 2016 2017 2018 2019
Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631
Total Assets 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594
Return of Assets -1% 0.1% 3.44% 3.14% 3.09%
Table 27 Return on Assets
Table shows how profitable a company is relative to its total assets. ROA gives an idea
as to how efficient management is at using its assets to generate earnings.
2015 2016 2017 2018 2019
Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631
Shareholder’s Equity 9,060,000,000 9,060,000,000 9,060,000,000 9,060,000,000 9,060,000,000
Return on Equity -0.7575% 0.0690% 3.6125% 3.4084% 3.4577%
Table 28 Return on Equity
Table shows the return on equity which measures a company's profitability by revealing
how much profit a company generates with the money shareholders have invested.
C. Activity Ratio
2015 2016 2017 2018 2019
Service Revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373
Total Assets 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594
Total Asset Turnover 0.011 0.021 0.066 0.064 0.063
Table 29 Total Asset Turnover
Table shows the turnover asset ratio which is an indicator of the efficiency with which a
company is deploying its assets.
Payback period
Investment 9,060,000,000
Average Net Income 316,455,952.30
Payback period 28.63 years
Table 30 Payback Period
This refers to the length of period or number of years it would take to recover an
investment. The business would take three years and 26 days to recover the
investment.
P a g e | 144
SOCIO – ECONOMIC
ASPECT
P a g e | 145
SOCIO – ECONOMIC ASPECT
Railways are the main artery of inland transport in an economy. They are an energy-
efficient mode of transportation, ideally suitable for large scale movement of manpower, bulk
commodities and for long distance travel. They are the lifeline of the country and hold great
importance in its socio-economic development. A well-established railway system brings
together people from the farthest corners of the country and makes possible the conduct of
business, sightseeing, pilgrimage and education. It improves the quality of life and thus helps to
accelerate the growth of industry and agriculture.
We will not operate just to gain profit but to help the government and the society through
the following aspect:
a. Gicha Ressha Train Company assures to provide high quality services for the country to
have a strong railway transit.
b. GRT Company is committed to being responsible and attractive employers.
c. To be able to maintain high levels of safety and security by comprehensive
management.
d. Apply precautionary approaches to environmental challenges and support initiatives,
projects and new technologies for further improved environmental performance.
Contribution to Society
GRT Company will be the backbone for sustainable mobility and transport systems in
our society. Rail offers solutions to cope with the mobility and transport challenges of the future.
Rail has lower impact on climate and environment than most other transport modes. It is the
safest mode of transport and relieves roads and reduces congestion. Our service has macro-
economic advantages for society and enhances sustainable integration of transport and mobility
modes.
Customer Commitment
Dedicated to provide with the best possible rail service. Our commitment to our
P a g e | 146
customers is our priority.
Government Contribution
GRT will provide a rail network that keeps cities moving and communities connected at
an acceptable cost to the taxpayer, and ensures passengers benefit from a high-performing,
affordable railway.
Contribution to Environment
Travelling by train is less carbon-intensive than travelling by car. Rail is the
environmentally friendly and socially responsible travel option.
P a g e | 147
APPENDICES
P a g e | 148
Appendix 1: Sample Size Computation
Slovin’s Formula
Where:
n = sample size
N = population (2014)
e = margin of error (5%)
= 400
P a g e | 149
Appendix 2: Survey Question
P a g e | 150
P a g e | 151
Appendix 3: Survey Results
P a g e | 152
P a g e | 153
P a g e | 154
P a g e | 155
P a g e | 156
P a g e | 157
P a g e | 158
P a g e | 159
P a g e | 160
P a g e | 161
P a g e | 162
6.07%
93.93%
h. If you are from Bayambang:
Yes
No
P a g e | 163
Appendix 4: Articles of Partnership
ARTICLES OF GENERAL PARTNERSHIP
KNOW ALL MEN BY THESE PRESENTS:
That we, Christian O. Bacoy, Filipino, single; Danica C. Balisi, Filipino, single; Jonathan Ray DL.
Rubico, Filipino, single, all of legal age and residents of Antipolo City have covenanted to
establish a partnership from this date, in accordance with existing laws,
AND WE HEREBY CERTIFY:
1. That the names, surnames, and addresses of the respective partners are as follows:
Name Address
Christian O. Bacoy Brgy. Dalig, Antipolo City
Danica C. Balisi Brgy. San Jose, Antipolo City
Jonathan Ray DL. Rubico Brgy. San Luis, Antipolo City
2. That the name of this partnership shall be Gicha Ressha Train Company, and it shall
exist for __ years from the execution of this instrument, with the right of transfer or
retirement of any partner provided written notice and approval are made to and by
the others;
3. That the capital of this partnership shall be ten billion pesos, (Php 10,000,000,000)
broken down, in contributions, as follows:

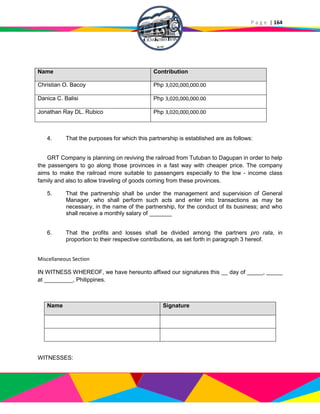

P a g e | 164
Name Contribution
Christian O. Bacoy Php 3,020,000,000.00
Danica C. Balisi Php 3,020,000,000.00
Jonathan Ray DL. Rubico Php 3,020,000,000.00
4. That the purposes for which this partnership is established are as follows:
GRT Company is planning on reviving the railroad from Tutuban to Dagupan in order to help
the passengers to go along those provinces in a fast way with cheaper price. The company
aims to make the railroad more suitable to passengers especially to the low - income class
family and also to allow traveling of goods coming from these provinces.
5. That the partnership shall be under the management and supervision of General
Manager, who shall perform such acts and enter into transactions as may be
necessary, in the name of the partnership, for the conduct of its business; and who
shall receive a monthly salary of _______
6. That the profits and losses shall be divided among the partners pro rata, in
proportion to their respective contributions, as set forth in paragraph 3 hereof.
Miscellaneous Section
IN WITNESS WHEREOF, we have hereunto affixed our signatures this __ day of _____, _____
at _________, Philippines.
Name Signature
WITNESSES:

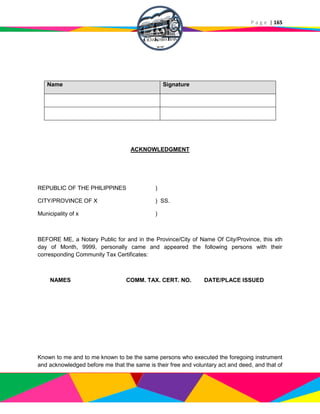

P a g e | 165
Name Signature
ACKNOWLEDGMENT
REPUBLIC OF THE PHILIPPINES )
CITY/PROVINCE OF X ) SS.
Municipality of x )
BEFORE ME, a Notary Public for and in the Province/City of Name Of City/Province, this xth
day of Month, 9999, personally came and appeared the following persons with their
corresponding Community Tax Certificates:
NAMES COMM. TAX. CERT. NO. DATE/PLACE ISSUED
Known to me and to me known to be the same persons who executed the foregoing instrument
and acknowledged before me that the same is their free and voluntary act and deed, and that of

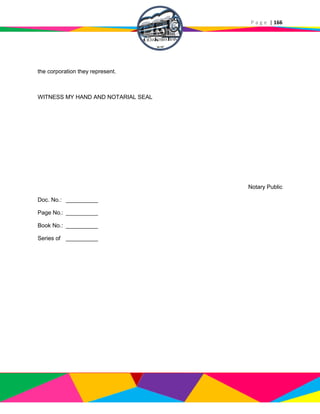

P a g e | 166
the corporation they represent.
WITNESS MY HAND AND NOTARIAL SEAL
Notary Public
Doc. No.: __________
Page No.: __________
Book No.: __________
Series of __________
P a g e | 167

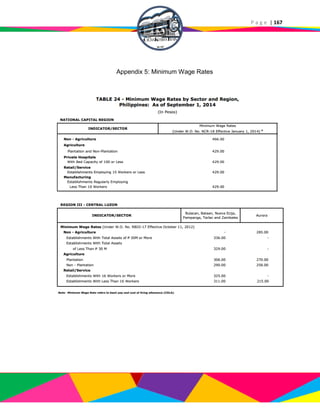

Appendix 5: Minimum Wage Rates
P a g e | 168
Appendix 6: SSS Contribution Table
Source:
http://www.bles.dole.gov.ph/PUBLICATIONS/Current%20Labor%20Statistics/STATISTICAL%20TABLE
S/PDF/tab24.pdf
P a g e | 169
Appendix 6: SSS Table Contribution
Source: Social Security System Official Website, 2014
http://www.ssscontributiontable.com/
P a g e | 170
Appendix 7: PhilHealth Contribution Table
*Employee share represents half of the total monthly premium
while the other half is shouldered by the employer.
Source: http://www.philhealth.gov.ph/partners/employers/contri_tbl.html
P a g e | 171
Appendix 8: Pag-Ibig Fund Contribution
Source: http://amaranthbiz.wordpress.com/2013/01/16/sss-philhealth-pag-ibig-hdmf-contributions/
P a g e | 172
Appendix 9: Tax Rate
What is the income tax rate in the Philippines?
For individuals earning purely compensation income and those engaged in business
and practice of profession, the applicable tax rate table is as follows:
Taxable Income Tax Rate
More than But less than
0 P10,000 5%
P10,000 P30,000 P500 + 10% of the Excess over P10,000
P30,000 P70,000 P2,500 + 15% of the Excess over P30,000
P70,000 P140,000 P8,500 + 20% of the Excess over P70,000
P140,000 P250,000 P22,500 + 25% of the Excess over P140,000
P250,000 P500,000 P50,000 + 30% of the Excess over P250,000
P500,000
P125,000 + 32% of the Excess over P500,000 in
2000 and onward
 For domestic corporations, the corporate tax rate is 30% of the Net taxable
income from all sources starting January 1, 2009.
 For proprietary educational institutions and non-stock, non-profit hospitals, the
tax rate is 10% of the Net taxable income, provided that the gross income from
unrelated trade, business or other activity does not exceed 50% of the total gross
income.
 For GOCCs, agencies & instrumentalities, the tax rate is 32% of the Net taxable
income from all sources.
 For all taxable partnerships, the tax rate is also 32% of the Net taxable income
from all sources.
 International Carriers are taxed 2.5% on their Gross Philippine Billings.
 For Regional Operating Headquarters (ROHQ), the tax rate is 10% of Taxable
Income.
Source: http://www.pinoymoneytalk.com/income-tax-rates-exemptions/#sthash.HPejKA9S.dpuf
P a g e | 173

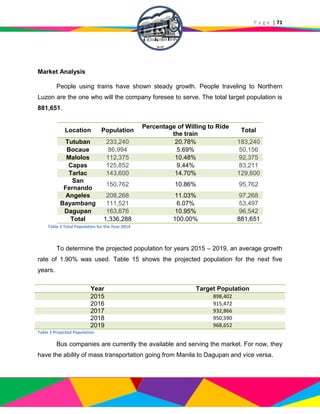

Appendix 10: Projected Demand
Year
Target
Population
% of
Population
who are
willing to
ride train
Market
Acceptability
Potential
Target
Market
Percentage Frequency Annual Demand
Total Annual
DemandEvery
Week
Once a
month
Once a
year
Others
Every Week
(54)
Once a month
(12)
Once a
year
(1)
Others
(4)
2015 898,402 47.25% 71.25% 302,452.77 20.50% 35.00% 28.50% 16.00% 3,348,152.19 1,270,301.64 86,199.04 193,569.77 4,898,222.65
2016 915,472 47.25% 71.25% 308,199.38 20.50% 35.00% 28.50% 16.00% 3,411,767.08 1,294,437.38 87,836.82 197,247.60 4,991,288.88
2017 932,866 47.25% 71.25% 314,055.16 20.50% 35.00% 28.50% 16.00% 3,476,590.66 1,319,031.69 89,505.72 200,995.30 5,086,123.37
2018 950,590 47.25% 71.25% 320,022.21 20.50% 35.00% 28.50% 16.00% 3,542,645.88 1,344,093.29 91,206.33 204,814.22 5,182,759.71
2019 968,652 47.25% 71.25% 326,102.63 20.50% 35.00% 28.50% 16.00% 3,609,956.15 1,369,631.06 92,939.25 208,705.69 5,281,232.15
P a g e | 174
Appendix 11: Price Computation for the Year 2015 – 2019
2015
Material Amount 2014supply unit cost
Train 153,750,875 1,084,644 141.7524
Direct Labor 2,731,560 1,084,644 2.518393
Overhead Cost
Power 1,398,592.04 1,084,644 1.289448
Water 360,363.60 1,084,644 0.332241
Total 145.8925
2016
Material amount 2014supply unit cost
Train 153,750,875 1,084,644 141.7524
Direct Labor 2,731,560 1,084,644 2.518393
Overhead Cost
Power 1,468,521.64 1,084,644 1.35392
Water 378,381.68 1,084,644 0.348853
Total 145.9736
2017
Material amount 2014supply unit cost
Train 153,750,875 1,084,644 141.7524
Direct Labor 2,731,560 1,084,644 2.518393
Overhead Cost
Power 1,541,947.72 1,084,644 1.421616
Water 397,300.87 1,084,644 0.366296
Total 146.0587
2018
Material amount 2014supply unit cost
Train 153,750,875 1,084,644 141.7524
Direct Labor 2,731,560 1,084,644 2.518393
Overhead Cost
Power 1,619,045.11 1,084,644 1.492697
Water 417,165.91 1,084,644 0.384611
Total 146.1481
2019
Material amount 2014supply unit cost
Train 153,750,875 1,084,644 141.7524
Direct Labor 2,731,560 1,084,644 2.518393
Overhead Cost
Power 1,699,997.36 1,084,644 1.567332
Water 438,024.81 1,084,644 0.403842
Total 146.242
P a g e | 175
Appendix 12: Sales Computation for the Year 2015 – 2019
2015
Service Capacity Percentage
Sales in
Units
Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 3,615,480 20.78% 751,432 - - - -
Bocaue 3,615,480 5.69% 205,680 180.00 37,022,407.59 3,966,686.53 33,055,721.07
Malolos 3,615,480 10.48% 378,812 180.00 68,186,157.22 7,305,659.70 60,880,497.52
TOTAL 105,208,564.82 11,272,346.23 93,936,218.59
2016
Service Capacity Percentage
Sales in
Units
Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 3,615,480 20.78% 826,574.93 - - - -
Bocaue 3,615,480 5.69% 226,248.05 180.00 40,724,648.35 4,363,355.18 36,361,293.17
Malolos 3,615,480 10.48% 416,693.18 180.00 75,004,772.94 8,036,225.67 66,968,547.27
San
Fernando
3,615,480 9.44% 73,148 230.00 16,824,040.00 1,802,575.71 15,021,464.29
Angeles 3,615,480 14.70% 109,419 230.00 25,166,370.00 2,696,396.79 22,469,973.21
Capas 3,615,480 10.86% 127,467 280.00 35,690,760.00 3,824,010.00 31,866,750.00
TOTAL 193,410,591.30 20,722,563.35 172,688,027.94
2017
Service Capacity Percentage
Sales in
Units
Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,067,415 20.78% 834,840.68 - - - -
Bocaue 4,067,415 5.69% 228,510.53 180.00 41,131,894.84 4,406,988.73 36,724,906.11
Malolos 4,067,415 10.48% 420,860.11 180.00 75,754,820.67 8,116,587.93 67,638,232.74
P a g e | 176

San
Fernando
4,067,415 9.44% 73,879.48 230.00 16,992,280.40 1,820,601.47 15,171,678.93
Angeles 4,067,415 14.70% 110,513.19 230.00 25,418,033.70 2,723,360.75 22,694,672.95
Capas 4,067,415 10.86% 128,741.67 280.00 36,047,667.60 3,862,250.10 32,185,417.50
tarlac 4,067,415 11.03% 448,737 330.00 148,083,171.61 15,866,054.10 132,217,117.51
Bayambang 4,067,415 6.07% 246,803 380.00 93,785,307.45 10,048,425.80 83,736,881.65
Dagupan 4,067,415 10.95% 445,388 430.00 191,516,646.54 20,519,640.70 170,997,005.84
TOTAL 628,729,822.81 67,363,909.59 561,365,913.22
2018
Service Capacity Percentage
Sales in
Units
Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,293,383 20.78% 843,189.08 - - - -
Bocaue 4,293,383 5.69% 230,795.63 180.00 41,543,213.79 4,451,058.62 37,092,155.17
Malolos 4,293,383 10.48% 425,068.72 180.00 76,512,368.88 8,197,753.81 68,314,615.07
San
Fernando
4,293,383 9.44% 74,618.27 230.00 17,162,203.20 1,838,807.49 15,323,395.72
Angeles 4,293,383 14.70% 111,618.32 230.00 25,672,214.04 2,750,594.36 22,921,619.68
Capas 4,293,383 10.86% 130,029.09 280.00 36,408,144.28 3,900,872.60 32,507,271.68
tarlac 4,293,383 11.03% 453,224.25 330.00 149,564,003.33 16,024,714.64 133,539,288.68
Bayambang 4,293,383 6.07% 249,271.48 380.00 94,723,160.52 10,148,910.06 84,574,250.47
Dagupan 4,293,383 10.95% 449,841.43 430.00 193,431,813.01 20,724,837.11 172,706,975.90
TOTAL 635,017,121.04 68,037,548.68 566,979,572.35
2019
Service Capacity Percentage
Sales in
Units
Price Sales - VAT Inclusive 12% Sales - VAT exclusive
Tutuban 4,519,350 20.78% 851,620.97 - - - -
P a g e | 177
Bocaue 4,519,350 5.69% 233,103.59 180.00 41,958,645.92 4,495,569.21 37,463,076.72
Malolos 4,519,350 10.48% 429,319.40 180.00 77,277,492.57 8,279,731.35 68,997,761.22
San
Fernando
4,519,350 9.44% 75,364.46 230.00 17,333,825.24 1,857,195.56 15,476,629.68
Angeles 4,519,350 14.70% 112,734.51 230.00 25,928,936.18 2,778,100.30 23,150,835.87
Capas 4,519,350 10.86% 131,329.38 280.00 36,772,225.72 3,939,881.33 32,832,344.39
tarlac 4,519,350 11.03% 457,756.50 330.00 151,059,643.36 16,184,961.79 134,874,681.57
Bayambang 4,519,350 6.07% 251,764.19 380.00 95,670,392.13 10,250,399.16 85,419,992.97
Dagupan 4,519,350 10.95% 454,339.84 430.00 195,366,131.14 20,932,085.48 174,434,045.66
TOTAL 641,367,292.25 68,717,924.17 572,649,368.08
P a g e | 178
Appendix 13: Purchases for 2015
2015
Toilet Fixtures (Station)
Item Unit Cost Quantity/Supplier Total Cost
Life
span
Depreciation
Cost
1. Urinal 1 pcs 2,895 18/ ACE Hardware 52,100 20
2. Toilet bowl w/ Spray 1 pcs 3,050 36/ ACE Hardware 109,800 20
Total 161,900 8095
Office Equipment
Item Unit Unit Cost Quantity (Annual)/ Supplier Total Cost
Life
Span
Depreciation
Cost
1. Computer Set 1 Set 4,500 8/ Pc Gilmore Computer Center 36,000 5 years 7200
2. 3 in 1 Printer 1 Unit 2,000 2/ Pc Gilmore Computer Center 4,000 5 years 800
3. Aircon 1 Unit 12,000 3/ Pc Gilmore Computer Center 36,000
10
years
3,600
4. Fax Machine 1 Unit 5,800 1/villman 5,800 5 years 1160
5.Water Dispenser 1 unit 4,798 1/ Abenson 4,798 5 years 959.6
6. Refrigirator 1 unit 7,695 1/ Lazada 7,695
10
years
769.5
7. CCTV Camera 1 Package 1,180 10/ CDR King 11,800 5 years 2360
Total 106,093 16,849.10
Office Supplies
Item Unit Unit Cost Quantity (Annual)/ Supply Total cost
Life
Span
Depreciation
Cost
1. Black Ballpen
25.00
pcs/box
90 6/ Office 1 e-shop 540
P a g e | 179
2. Paper Clips 100 pcs/ box 13.75 1/ Office 1 e-shop 13.75
3. Bond paper (A4) 1 Rim 140 1/Office 1 e-shop 140
4. Record Book (300
leaves)
1 pc 41.25 4/Office 1 e-shop 165
5. Folder (Long) 1 2.5 10/Office 1 e-shop 25
6. Marker 12 pcs/box 96 1/ Office 1 e-shop 96
7. Stapler 1 pc 45 2/ Office 1 e-shop 90
8. Staple wire 1 box 4.83 4/ Office 1 e-shop 19.32
9. Staple Remover 1 pc 12 2/ Office 1 e-shop 24
10. Journal 4 books/ set 400 1/Office 1 e-shop 400
11. Ink for Printer 1 set 1,200.00 1/ Office 1 e-shop 1,200.00
12. Paper roll 1 roll 8.75 80/ Office 1 e-shop 700
Total 3413.07
Office Furnitures
Item Unit Cost Quantity/Supplier Total Cost
Life
span
Depreciation
Cost
1. Office Desk 1 2,500 7/ ADB Office Furniture 17,500 5
2. Office Chair 1 650 7/ ADB Office Furniture 4,550 5
3. Filing Cabinet 1 4,300 1/ ADB Office Furniture 4,300 15
4. Monobloc 1 320 3/ ADB Office Furniture 640 10
5. Fire Extinguisher 1 7,800 3/ ADB Office Furniture 23,400 10
6. Storage Cabinet 1 1,999 6/ ADB Office Furniture 11,994 10
Total 62,384
Service Supplies (Direct Materials)
Item Unit Cost Quantity/Supplier Total Cost
Life
span
Depreciation
Cost
P a g e | 180
1. Train 1 pc 157,750,875 9/ Japan Railway System 1,419,757,875
50
years
2. Railway 1 km 34,400,000 214/ Japan Railway System 7,361,600,000
50
years
3. Clock 1 pc 295 18/ Western Digital 5310 5 years
4. Automatic Card Reader 1 pcs 150,000 72/ 10,800,000
15
years
Total 8,792,163,185 176,348,219.50
Janitorial and Comfort Room Supplies and Expenses
Item Unit Cost Quantity/Supplier Total Cost
Life
span
Depreciation
Cost
Air Freshener 1 piece 140 36 5040
Broom 1 piece 120 18 2160
Stickbroom 1 piece 10 9 90
Dust pan 1 piece 80 18 1440
Floor Mop 1 piece 180 9 1620
Garbage Bags 1 piece 10 225 2250
Garbage Cans 1 piece 100 18 1800
Liquid Soap (Exel) 1 bottle 60 90 5400
Hand Wash 1 bottle 35 36 1260
Toilet Paper 1 roll 10 450 4500
Total 25560
Total Annual Expense 306720
Uniform Expense
Item Unit Cost Quantity/Supplier Total Cost
Life
span
Depreciation
Cost
Train driver 1 9 500 4500
P a g e | 181
Appendix 14: Purchases for 2016
2016
Toilet Fixtures (Station)
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
1. Urinal 1 pc 18/ ACE Hardware 20 years
2. Toilet bowl w/ Spray 1 pc 36/ ACE Hardware 20 years 5490
Total
Office Equipment
Item Unit
Unit
Cost
Quantity (Annual)/ Supplier
Total
Cost
Life
Span
Depreciation Cost
1. Computer Set 1 Set
8/ Pc Gilmore Computer
Center
5 years
2. 3 in 1 Printer 1 Unit
2/ Pc Gilmore Computer
Center
5 years
3. Aircon 1 Unit
3/ Pc Gilmore Computer
Center
10 years
4. Fax Machine 1 Unit 1/villman 5 years
5.Water Dispenser 1 unit 1/ Abenson 5 years
6. Refrigirator 1 unit 1/ Lazada 10 years
7. CCTV Camera 1 Package 10/ CDR King 5 years
Total
Office Supplies
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
1. Black Ballpen
25.00
pcs/box
91.8 6/ Office 1 e-shop 550.8
2. Paper Clips
100 pcs/
box
14.025 1/ Office 1 e-shop 14.025
P a g e | 182
3. Bond paper (A4) 1 Rim 142.8 1/Office 1 e-shop 142.8
4. Record Book (300
leaves)
1 pc 42.075 4/Office 1 e-shop 168.3
5. Folder (Long) 1 2.55 10/Office 1 e-shop 25.5
6. Marker 12 pcs/box 97.92 1/ Office 1 e-shop 97.92
7. Stapler 1 pc 45.9 2/ Office 1 e-shop 91.8
8. Staple wire 1 box 4.9266 4/ Office 1 e-shop 19.7064
9. Staple Remover 1 pc 12.24 2/ Office 1 e-shop 24.48
10. Journal 4 books/ set 408 1/Office 1 408
11. Ink for Printer 1 set 1,224.00 1/ Office 1 e-shop 1,224.00
12. Paper roll 1 roll 8.925 80/ Office 1 e-shop 714
Total 3481.3314
Office Furnitures
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
1. Office Desk 1 7/ ADB Office Furniture 5 years
2. Office Chair 1 7/ ADB Office Furniture 5 years
3. Filing Cabinet 1 1/ ADB Office Furniture 15 years
4. Monobloc 1 3/ ADB Office Furniture 10 years
5. Fire Extinguisher 1 3/ ADB Office Furniture 10 years
6. Storage Cabinet 1 6/ ADB Office Furniture 10 years
Total
Service Supplies (Direct Materials)
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
1. Train 1 pc 9/ Japan Railway System 50 years
2. Railway 1 km 214/ Japan Railway System 50 years
P a g e | 183

3. Clock 1 pc 18/ Western Digital 5 years
4. Automatic Card Reader 1 pcs 72 pcs 15 years
Total
Janitorial and Comfort Room Supplies and Expenses
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
Air Freshener piece 142.8 36 5140.8
Broom piece 122.4 18 2203.2
Stickbroom piece 10.2 9 91.8
Dust pan piece 81.6 18 1468.8
Floor Mop piece 183.6 9 1652.4
Garbage Bags piece 10.2 225 2295
Garbage Cans piece 102 18 1836
Liquid Soap (Exel) bottle 61.2 90 5508
Hand Wash bottle 35.7 36 1285.2
Toilet Paper roll 10.2 450 4590
Total 26071.2
Total Annual Expense 312854.4
Uniform Expense
Item Unit Cost Quantity/Supplier
Total
Cost
Life
Span
Depreciation Cost
Train driver 9 500 4500
P a g e | 184
Appendix 15: Purchases for 2017
2017
Toilet Fixtures (Station)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Urinal 1 pcs 18/ ACE 20
2. Toilet bowl w/ Spray 1 pcs 36/ ACE 20
Total 161,900
Office Equipment
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Computer Set 1 Set
8/ Pc Gilmore Computer
Center
5 years
2. 3 in 1 Printer 1 Unit
2/ Pc Gilmore Computer
Center
5 years
3. Aircon 1 Unit
3/ Pc Gilmore Computer
Center
10 years
4. Fax Machine 1 Unit 1/villman 5 years
5.Water Dispenser 1 unit 1/ Abenson 5 years
6. Refrigirator 1 unit 1/ Lazada 10 years
7. CCTV Camera 1 Package 10/ CDR King 5 years
Total
Office Supplies
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Black Ballpen
25.00
pcs/box
93.636 6/ Office 1 561.816
2. Paper Clips
100 pcs/
box
14.3055 1/ Office 1 14.3055
P a g e | 185
3. Bond paper (A4) 1 Rim 145.656 1/Office 1 145.656
4. Record Book (300
leaves)
1 pc 42.9165 4/Office 1 171.666
5. Folder (Long) 1 2.601 10/Office 1 26.01
6. Marker 12 pcs/box 99.8784 1/ Office 1 99.8784
7. Stapler 1 pc 46.818 2/ Office 1 93.636
8. Staple wire 1 box 5.02513 4/ Office 1 20.100528
9. Staple Remover 1 pc 12.4848 2/ Office 1 24.9696
10. Journal 4 books/ set 416.16 1/Office 1 416.16
11. Ink for Printer 1 set 1,248.48 1/ Office 1 1,248.48
12. Paper roll 1 roll 9.1035 80/ Office 1 728.28
Total 3550.95803
Office Furnitures
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Office Desk 1 7/ ADB Office Furniture 5
2. Office Chair 1 7/ ADB Office Furniture 5
3. Filing Cabinet 1 1/ ADB Office Furniture 15
4. Monobloc 1 3/ ADB Office Furniture 10
5. Fire Extinguisher 1 3/ ADB Office Furniture 10
6. Storage Cabinet 1 6/ ADB Office Furniture 10
Total
Service Supplies (Direct Materials)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Train 1 pc 9/ Japan Railway System 50 years
2. Railway 1 km 214/ Japan Railway System 50 years
P a g e | 186
3. Clock 1 pc 18/ Western Digital 5 years
4. Automatic Card Reader 1 pcs 72 pcs 15 years
Total
Janitorial and Comfort Room Supplies and Expenses
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
Air Freshener piece 145.656 36 5243.616
Broom piece 124.848 18 2247.264
Stickbroom piece 10.404 9 93.636
Dust pan piece 83.232 18 1498.176
Floor Mop piece 187.272 9 1685.448
Garbage Bags piece 10.404 225 2340.9
Garbage Cans piece 104.04 18 1872.72
Liquid Soap (Exel) bottle 62.424 90 5618.16
Hand Wash bottle 36.414 36 1310.904
Toilet Paper roll 10.404 450 4681.8
Total 26592.624
Total Annual Expense 319111.488
Uniform Expense
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
train driver 9 500 4500
P a g e | 187
Appendix 16: Purchases for 2018
2017
Toilet Fixtures (Station)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Urinal 1 pcs 18/ ACE Hardware 20
2. Toilet bowl w/ Spray 1 pcs 36/ ACE Hardware 20
Total
Office Equipment
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Computer Set 1 Set
8/ Pc Gilmore Computer
Center
5 years
2. 3 in 1 Printer 1 Unit
2/ Pc Gilmore Computer
Center
5 years
3. Aircon 1 Unit
3/ Pc Gilmore Computer
Center
10 years
4. Fax Machine 1 Unit 1/villman 5 years
5.Water Dispenser 1 unit 1/ Abenson 5 years
6. Refrigirator 1 unit 1/ Lazada 10 years
7. CCTV Camera 1 Package 10/ CDR King 5 years
Total
Office Supplies
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Black Ballpen
25.00
pcs/box
95.50872 6/ Office 1 e-shop 573.05232
2. Paper Clips
100 pcs/
box
14.59161 1/ Office 1 e-shop 14.59161
P a g e | 188
3. Bond paper (A4) 1 Rim 151.540502 1/Office 1 e-shop 151.540502
4. Record Book (300
leaves)
1 pc 43.77483 4/Office 1 e-shop 175.09932
5. Folder (Long) 1 2.65302 10/Office 1 e-shop 26.5302
6. Marker 12 pcs/box 101.875968 1/ Office 1 e-shop 101.875968
7. Stapler 1 pc 47.75436 2/ Office 1 e-shop 95.50872
8. Staple wire 1 box 5.12563464 4/ Office 1 e-shop 20.5025386
9. Staple Remover 1 pc 12.734496 2/ Office 1 e-shop 25.468992
10. Journal 4 books/ set 424.4832 1/Office 1 424.4832
11. Ink for Printer 1 set 1,273.45 1/ Office 1 e-shop 1,273.45
12. Paper roll 1 roll 9.28557 80/ Office 1 e-shop 742.8456
Total 3624.94857
Office Furnitures
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Office Desk 1 7/ ADB Office Furniture 5
2. Office Chair 1 7/ ADB Office Furniture 5
3. Filing Cabinet 1 1/ ADB Office Furniture 15
4. Monobloc 1 3/ ADB Office Furniture 10
5. Fire Extinguisher 1 3/ ADB Office Furniture 10
6. Storage Cabinet 1 6/ ADB Office Furniture 10
Total
Service Supplies (Direct Materials)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Train 1 pc 9/ Japan Railway System 50 years
2. Railway 1 km 214/ Japan Railway System 50 years
P a g e | 189
3. Clock 1 pc 18/ Western Digital 5 years
4. Automatic Card Reader 1 pcs 72 pcs 15 years
Total
Janitorial and Comfort Room Supplies and Expenses
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
Air Freshener 1 piece 148.56912 36 5348.48832
Broom 1 piece 127.34496 18 2292.20928
Stickbroom 1 piece 10.61208 9 95.50872
Dust pan 1 piece 84.89664 18 1528.13952
Floor Mop 1 piece 191.01744 9 1719.15696
Garbage Bags 1 piece 10.61208 225 2387.718
Garbage Cans 1 piece 106.1208 18 1910.1744
Liquid Soap (Exel) 1 bottle 63.67248 90 5730.5232
Hand Wash 1 bottle 37.14228 36 1337.12208
Toilet Paper 1 roll 10.61208 450 4775.436
Total 27124.47648
Total Annual Expense 325493.7178
Uniform Expense
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
train driver 9 500 4500
P a g e | 190
Appendix 17: Purchases for 2019
2019
Toilet Fixtures (Station)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Urinal 1 pcs 18/ ACE Hardware 20
2. Toilet bowl w/ Spray 1 pcs 36/ ACE Hardware 20
Total
Office Equipment
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Computer Set 1 Set 8/ Pc Gilmore Computer Center 5 years
2. 3 in 1 Printer 1 Unit 2/ Pc Gilmore Computer Center 5 years
3. Aircon 1 Unit 3/ Pc Gilmore Computer Center
10
years
4. Fax Machine 1 Unit 1/villman 5 years
5.Water Dispenser 1 unit 1/ Abenson 5 years
6. Refrigirator 1 unit 1/ Lazada
10
years
7. CCTV Camera 1 Package 10/ CDR King 5 years
Total
Office Supplies
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Black Ballpen
25.00
pcs/box
97.4188944 6/ Office 1 e-shop 584.5133664
2. Paper Clips 100 pcs/ box 14.8834422 1/ Office 1 e-shop 14.8834422
3. Bond paper (A4) 1 Rim 154.571312 1/Office 1 e-shop 154.5713124
P a g e | 191
4. Record Book (300
leaves)
1 pc 44.6503266 4/Office 1 e-shop 178.6013064
5. Folder (Long) 1 2.7060804 10/Office 1 e-shop 27.060804
6. Marker 12 pcs/box 103.913487 1/ Office 1 e-shop 103.9134874
7. Stapler 1 pc 48.7094472 2/ Office 1 e-shop 97.4188944
8. Staple wire 1 box 5.22814733 4/ Office 1 e-shop 20.91258933
9. Staple Remover 1 pc 12.9891859 2/ Office 1 e-shop 25.97837184
10. Journal 4 books/ set 432.972864 1/Office 1 e-shop 432.972864
11. Ink for Printer 1 set 1,298.92 1/ Office 1 e-shop 1,298.92
12. Paper roll 1 roll 9.4712814 80/ Office 1 e-shop 757.702512
Total 3697.447542
Office Furnitures
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Office Desk 1 7/ ADB Office Furniture 5
2. Office Chair 1 7/ ADB Office Furniture 5
3. Filing Cabinet 1 1/ ADB Office Furniture 15
4. Monobloc 1 3/ ADB Office Furniture 10
5. Fire Extinguisher 1 3/ ADB Office Furniture 10
6. Storage Cabinet 1 6/ ADB Office Furniture 10
Total
Service Supplies (Direct Materials)
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
1. Train 1 pc 9/ Japan Railway System
50
years
2. Railway 1 km 214/ Japan Railway System
50
years
3. Clock 1 pc 18/ Western Digital 5 years
P a g e | 192
4. Automatic Card Reader 1 pcs 72 pcs
15
years
Total
Janitorial and Comfort Room Supplies and Expenses
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
Air Freshener piece 151.5405024 36 5455.458086
Broom piece 129.8918592 18 2338.053466
Stickbroom piece 10.8243216 9 97.4188944
Dust pan piece 86.5945728 18 1558.70231
Floor Mop piece 194.8477888 9 1753.630099
Garbage Bags piece 10.8243216 225 2435.47236
Garbage Cans piece 108.243216 18 1948.377888
Liquid Soap (Exel) bottle 64.9459296 90 5845.133664
Hand Wash bottle 37.88512256 36 1363.864412
Toilet Paper roll 10.8243216 450 4870.94472
Total 27667.0559
Total Annual Expense 332004.6708
Uniform Expense
Item Unit Cost Quantity/Supplier Total Cost
Life
Span
Depreciation Cost
train driver 9 500 4500
P a g e | 193

Feasibility study 2014

  • 1.
    P a ge | 1 EXECUTIVE SUMMARY
  • 2.
    P a ge | 2 The Company Gicha Ressha Train (GRT) is a private firm formed in 2014 to provide nation – side railroad and transportation system for people traveling to Northern Luzon. Aiming rehabilitates and modernizes transport facilities to effectively and efficiently performed mandated tasks. As the economic grows, it was essential to facilitate the restoration of abandoned Manila – Dagupan railroad. The main office is located at Natividad Building, T.M. Kalaw Street Ermita, Manila. GRT is determined to improve access and mobility for residents, employees and visitors to North Luzon. Minimize total travel time, transfers, and changes of mode by integrating the system. Dedicated to provide convenient access and improve connectivity to the regional transit system. Enhance the public image of the proposed transit improvements. Build community and political support through effective communication and integration with local and regional plans. Enhances the physical environment wherever possible. Implement an alternative that minimizes adverse impacts on the environment. Minimize air and noise pollution, vibration impacts, disturbance of public facilities, traffic and parking impacts. The company will be headed by the General Manager with the support of his subordinates. The Service GRT Company is planning on reviving the railroad from Tutuban to Dagupan in order to help the passengers to go along those provinces in a fast way with cheaper price. The company aims to make the railroad more suitable to passengers especially to the low - income class family and also to allow traveling of goods coming from these provinces.
  • 3.
    P a ge | 3 The Market Quality and safety traveling are the priorities of our services. Since there is already a railroad track from Tutuban to Dagupan, our primary target market will be the passengers going from Manila to Bulacan, Pampanga, Tarlac and Pangasinan and vice versa for leisure or business purposes. The total population target is 631,351. The Company’s Competitive Edge Quality and safety is guaranteed to the passengers in their whole trip. For a strong and reliable public mass transit. Financing Gicha Ressha Train will be financed by three investors with the capital of Php 10,000,000,000. The capital will be distributed for the current and long-term assets for the operation of the company.
  • 4.
    P a ge | 4 MANAGEMENT ASPECT
  • 5.
    P a ge | 5 MANAGEMENT ASPECT This chapter tackles the organization act and evaluation requirements in establishing business of any kind. This section focuses on different strategies and policies to be established and implemented during the course of the business. Effective organizational set-up made to be determined and define the duties and responsibilities of every personnel and to delegate and define each power in performing their respective assignments to attain the success of the business. Filipinos are very known to be as family-oriented. Some are still living with their parents even after they have their own families, and some get separated and tried to live on their own, and some did travel to find for their future in the urban like Manila and get stocked or chose to live in it. GRT Company is a company that aims to connect the urban cities to the rural areas and provinces in the Northern part of the country by reopening and reoperation of the late Northrail Line of Philippine National Railway. A business can never be form without its founder and support. Management is the very core of a business. They are the ones who’s running and leading the business into its success, or into its loss. THE COMPANY The name of the company is Gicha Ressha Train Company. The name Gicha is a Korean word meaning train. The name Ressha is a Japanese word meaning railroad. The name Train comes from the word itself because the firm’s line of industry is about railroad system. Translating the company’s name will be “Train Railroad Train” because this company is all about the railroad system in the Philippines specifically the Northrail Line of the Philippine National Railway or PNR. The founder of the company are mainly
  • 6.
    P a ge | 6 fanatics of the Korean and Japanese culture so they have chosen to use the foreign languages of “train” and “railroad” to form the company’s name. COMPANY LOGO The logo will serve as the symbol of the company. In the figure below, the initials are GRT and forming an image of a train. The initials stand for Gicha Ressha Train. Figure 1 Company Logo
  • 7.
    P a ge | 7 COMPANY MISSION GRT Company mission is to give the populace the benefit of using a fast, safe, reliable, and cheaper mobility access to rural centers of the northern part of the country through the development, reconstruction, and maintenance of the Northrail line of Philippine National Railway system. COMPANY VISION GRT Company envisions itself to be the country’s successful and leading transportation system that connects urban and rural areas, and mostly the people of these areas. COMPANY GOAL AND OBJECTIVES Gicha Ressha Train Co. aims to reconstruct and reopen the North Main Line system of Philippine National Railway or PNR Northrail that travel from Tutuban, Manila (Terminal Station) crossing into different rural areas and provinces to Dagupan, Pangasinan as the end terminal station, and vice versa.  To reconstruct the late Northrail line of Philippine National Railway  To operate the Northrail line of Philippine National Railway  To maintain the operation of the Northrail line of Philippine National Railway  To produce a fast, safe, reliable, and cheaper mode of transportation to the country’s Northern provinces and areas
  • 8.
    P a ge | 8 COMPANY OWNERSHIP The form of business organization Gicha Ressha Train Company chose was General Partnership. In General Partnership, a business entity is made up of two or more entities to carry on a trade or business. Each partner contributes money, property, labor, or special skills and each partner shares in the profits and losses from the business. In other words, each general partner takes part in the management of the business, and also takes responsibility for the liabilities of the business. If one partner is sued, all partners are held liable. The business will be easy to practice and organize and will operate more effectively and efficiently since two more persons are present for sharing ideas and strategies to achieve company’s goals and objectives. FORMING THE COMPANY After the agreement of forming the business, it must comply with government requirements for it to be legally established, and be operational. The following are the common requirements and fees are imposed in forming a business. 1. Securities and Exchange Commission (SEC) SEC is a Philippine state commission responsible for securities laws and regulating the securities industry. Registration with the SEC is a requirement for the issuance of licenses by the municipal or city government.
  • 9.
    P a ge | 9 The following are the requirements for the SEC registration: a. Name Verification Slip b. Accomplished Registration Data Sheet c. Articles of partnership 2. Department of Trade and Industry (DTI) One of DTI’s functions is to administer the registration of business names. Business name registration is compulsory and must be completed before the business starts operating. By registering the business name with the DTI, the proprietor is assured that no other individual or group may legally use the business name anywhere in the Philippines. The following requirements should be fulfilled: a. Registration Fee b. SEC Certificate c. Articles of partnership 3. Bureau of Internal Revenue (BIR) For taxation purposes, every business has to register with the BIR before the commencement of its operation. Any business should secure a company number and shall register with appropriate Revenue District Office (RDO) which has jurisdiction over the place where the main office is located. The company Tax number is permanent and it is to be used by business firm for several business purposes. The registration procedures are the following: a. Secure a permanent record file number of Tax Identification Number; b. Register the business name with the BIR Revenue District Office; and
  • 10.
    P a ge | 10 c. Pay the prescribed fees d. Apply for individual income tax return. 4. Municipal Permits or Licenses All businesses are required to secure a mayor’s permit or municipal license from the municipality or city where they are located. The following permits and licenses are needed in starting a particular business: a. Mayor’s Permit b. Business Tax c. Garbage Fee d. Sanitary Permit e. Signboards/Billboards f. Electric Permit The processing for the application of Mayor’s Permit, the requirement includes: a. Photocopy of Articles of partnership b. Photocopy of Certificates of SEC Registration c. Photocopy of DTI Registration d. Sanitary Permit secured from the municipal. Health Office that includes sanitary fee and garbage fee e. Fire Safety Permit f. Building Permit from the City Engineer’s Office g. Three (3) copies of business application form
  • 11.
    P a ge | 11 5. Social Security System (SSS) Registration All companies must be registered with SSS and must secure an employer number which will be used as a reference for the remittance of their monthly contributions. The forms needed for SSS registration are as follows: a. Employer Registration Form (R-1) b. Employment Report Form (R-1A) c. SEC Registration 6. Phil-Health Registration Phil-Health is the country’s Health Insurance Corporation. All employers are required to register their employees with Phil-Health as stated in the New National Health Insurance Act (RA 7875/RA 9241). This agency manages and administers the government health care system in the Philippines. The following documents are required by Phil-Health and as enumerated below: a. Employer Data Record (ER1) b. Report of Employee-Member (ER2) c. SEC Registration 7. Pag-IBIG (Home Development Mutual Fund) Registration Pag-IBIG Fund is also known as the Home Development Mutual Fund which is mandatory for all employees covered by the Social Security System (SSS). The Pag-IBIG Fund essentially provides various types of loans to the members.
  • 12.
    P a ge | 12 BASIC REQUIREMENTS AND PROCEDURES IN REGISTERING A BUSINESS 1. Reserve and Register Your Business Name in Securities and Exchange Commission (SEC), as follows:  Check if your desired business name is available via SEC online website or at SEC Office in Mandaluyong  If available, register/reserve your business name via SEC online website or at SEC Name Verification Unit – SEC Office in Mandaluyong  Prepare, sign and notarize the following: o Articles of partnership; o By Laws o Treasurer’s Affidavit; and o Joint affidavit of two incorporators undertaking to change corporate name immediately upon receipt of notice or directive from the Securities and Exchange Commission that another corporation, partnership, or person has acquired a prior right to the use of that name or that name has been declared misleading, deceptive, confusingly similar to a registered name, or contrary to public morals, good customs or public policy. (Not required if the Articles of Incorporation have a provision on this commitment).  Submit notarized documents to SEC Office in Mandaluyong City  Claim your SEC Certificate of Registration Processing Time: At least one (1) week upon submission of complete documents 2. Acquire Barangay Clearance Once the corporation is registered with SEC the next step is to get a barangay clearance in the barangay where your business is located.
  • 13.
    P a ge | 13 Here are the basic steps  Go to the barangay where your business is located to secure and fill-up application form  Submit your completed application form together with the following: o Certificate of Business Registration from SEC o Two (2) valid IDs, Proof of Address such as Contract of Lease (if rented) or Certificate of Land Title (if owned) Processing Time: 1 day upon submission of complete documents. 3. Acquire Business Permit from the Mayor’s Office Once you have a Barangay Clearance Certificate, the next step is to acquire a Business Permit in the municipality where your business is located. Here are the basic steps and requirements:  Go to the municipal office where your business is located to secure and fill-up application form  Submit your completed application form together with the following: o Certificate of Business Registration from SEC o Barangay Clearance Certificate o Two (2) valid IDs, Proof of Address such as Contract of Lease (if rented) or Certificate of Land Title (if owned) Processing Time: At least one week upon submission of complete documents. But It can take longer depending on the permit requirements based on the industry. 4. Register with the Bureau of Internal Revenue (BIR) Once you have the Mayor’s Business Permit, you can now register with the BIR. Here are the basic steps and requirements:
  • 14.
    P a ge | 14  Go to the Regional District Office (RDO) where your business is located  Fill-up registration form as follows: o BIR Form 1903 – Application for Registration (For Partnership/Corporation)  Submit completed registration form together with the following: o Certificate of Registration form SEC o Barangay Clearance o Business Permit From the Mayor’s Office o Proof of Address such as Contract of Lease (if rented) or Certificate of Land Title (if owned) o Valid IDs, if applicable.  Pay the Registration Form (BIR Form 0605) and Documentary Stamp Tax (BIR Form 2000), if applicable.  Register your book of accounts and receipts/invoices.  Claim your Certificate of Registration (BIR Form 2303)
  • 15.
    P a ge | 15 COMPANY LOCATION The proposed location for the business office will be at 3F Natividad Bldg., T.M. Kalaw St., Ermita, Manila. The 75 square meter floor area of the said establishment will be chartered by the company for at least 20 years and/or with extension if needed. Figure 2 Office Location
  • 16.
    P a ge | 16 OPERATING HOURS AND WORK SCHEDULES The Gicha Ressha Train Company office will be operating from 8:00AM to 5:00PM every weekdays, Monday to Friday. Administrative employees will be having morning break of 15-minutes break from 10:00AM, lunch break of 30 minutes from 12:00 noon, and another 15-minutes break from 2:45PM. Since the company is in partnership with the Philippine National Railway administration, the employees require to have a field work and site inspection to check for the progress of the project, an employee has to file for an itinerary letter a day before the appointment date if he/she is going on the field. The GRT Company trains will be operating from 5:00 AM to 11:00 PM everyday, Monday to Sunday. Employees or personnel from the stations like security guards, ticket operators, and maintenance personnel are require to work a minimum of eight (8) hours a day inclusive of their breaks. Lunch and break time are not too tight as long as they follow the rules regarding the subject, and can perform task assigned to them. Their schedules will be shifting basis so that the station will still be operational along the day.
  • 17.
    P a ge | 17 ORGANIZATIONAL CHART Figure 3 Organizational Chart The figure shows the organizational structure of Gicha Ressha Train Corporation from top to lower management who would run the company. The business is classified as Corporation as agreed by the owners and due to the complexity of the purpose of the project. The General Manager will overlook to the company to reach its goals and serve its purpose for greater good which will be supported by a Construction Supervisor/Estimator, Financial Planner, Operations Engineer, Project Engineer Human
  • 18.
    P a ge | 18 Resource Manager and their assistants. Other personnel will be hired then for their designated works such as Train Operators, Ticket Vendor, Maintenance Personnel, and Security Guard. JOB DESCRIPTIONS AND QUALIFICATIONS  GENERAL MANAGER Job Description  Increases management's effectiveness by recruiting, selecting, orienting, training, coaching, counseling, and disciplining managers; communicating values, strategies, and objectives; assigning accountabilities; planning, monitoring, and appraising job results; developing incentives; developing a climate for offering information and opinions; providing educational opportunities.  Develops strategic plan by studying technological and financial opportunities; presenting assumptions; recommending objectives.  Accomplishes subsidiary objectives by establishing plans, budgets, and results measurements; allocating resources; reviewing progress; making mid- course corrections.  Coordinates efforts by establishing procurement, production, marketing, field, and technical services policies and practices; coordinating actions with corporate staff.  Builds company image by collaborating with customers, government, community organizations, and employees; enforcing ethical business practices.  Maintains quality service by establishing and enforcing organization standards.
  • 19.
    P a ge | 19  Maintains professional and technical knowledge by attending educational workshops; reviewing professional publications; establishing personal networks; benchmarking state-of-the-art practices; participating in professional societies.  Contributes to team effort by accomplishing related results as needed. Qualifications  Male/Female, 30-35years old  Graduate of Industrial Engineering or any managerial course  With knowledge in Management Engineering  Minimum of 3 years of experience in Managerial Position  OPERATIONS MANAGER Job Description  Identifies operational problems by observing and studying system functioning and performance results; investigating complaints and suggestions; interviewing process supervisors and operators; completing troubleshooting procedures.  Identifies operational priorities by assessing operational objectives; determining project objectives, such as, efficiency, cost savings, energy conservation, operator convenience, safety, environmental quality; estimating relevance, time, and costs.  Develops operational solutions by defining, studying, estimating, and screening alternative solutions; calculating economics; determining impact on total system.
  • 20.
    P a ge | 20  Anticipates operational problems by studying operating targets, modes of operation, unit limitations; monitoring unit performance.  Improves operational quality results by studying, evaluating, and recommending process re-design; implementing changes; contributing information and opinion to unit design and modification teams.  Maintains safe and healthy work environment by following and enforcing standards and procedures; complying with legal regulations.  Provides operational management information by collecting, analyzing, and summarizing operating and engineering data and trends.  Updates job knowledge by participating in educational opportunities; reading professional publications; maintaining personal networks; participating in professional organizations.  Accomplishes engineering and organization mission by completing related results as needed. Qualifications  Male/Female, 25-35years old  Graduate of Industrial Engineering or any managerial course  With knowledge in Operations Research, Safety Management, Reporting skills, or any related  Minimum of 2 years of experience in related position
  • 21.
    P a ge | 21  FIELD SUPERVISOR Job Description  Prepare daily production reports (passenger counts of the train)  Assign and coordinate the daily task of laborers  Report any field problems to the General Manager Qualifications  Male, 23-30 years old  Graduate of Mechanical, or any related course  With knowledge in Requirements Analysis, Design Skills, Project Management, Manufacturing Methods and Procedures, Process Improvement, Technical Understanding, Documentation Skills, Safety Management, Supervision  Service oriented and hardworking  Good observation and reporting skills  RAILWAY ENGINEER Job Description  Develops project objectives by reviewing project proposals and plans; conferring with management.  Determines project responsibilities by identifying project phases and elements; assigning personnel to phases and elements; reviewing bids from contractors.  Determines project specifications by studying product design, customer requirements, and performance standards; completing technical studies; preparing cost estimates.
  • 22.
    P a ge | 22  Confirms product performance by designing and conducting tests.  Determines project schedule by studying project plan and specifications; calculating time requirements; sequencing project elements.  Maintains project schedule by monitoring project progress; coordinating activities; resolving problems.  Controls project plan by reviewing design, specifications, and plan and schedule changes; recommending actions.  Controls project costs by approving expenditures; administering contractor contracts.  Prepares project status reports by collecting, analyzing, and summarizing information and trends; recommending actions.  Maintains safe and clean working environment by enforcing procedures, rules, and regulations.  Maintains project data base by writing computer programs; entering and backing up data.  Maintains product and company reputation by complying with federal and state regulations.  Contributes to team effort by accomplishing related results as needed. Qualifications  Male/Female, 25-35years old  Graduate of Industrial Engineering , Civil, Mechanical Engineering, or any related course  With knowledge in Requirements Analysis, Design Skills, Project Management, Manufacturing Methods and Procedures, Process
  • 23.
    P a ge | 23 Improvement, Technical Understanding, Documentation Skills, Safety Management, Supervision, CAD, CAD/CAM Circuit Design  Minimum of 2 years of experience in related position  ASSISTANT ENGINEER Job Description  Determines engineering requirements by conducting inspections and analytical tests; analyzing and synthesizing data; maintaining control charts; determining root causes; preparing bid specifications.  Resolves engineering problems by collecting and analyzing information; researching, analyzing, adapting, and modifying engineering techniques; recommending solutions; preparing drawings, schematics, and diagrams; evaluating components, materials, and suppliers; resolving design integration issues; developing specifications and safety standards; performing installations.  Verifies engineering applications by conducting tests and inspections; building and analyzing models and simulations; conducting laboratory experiments and measurements.  Maintains project team accomplishments by communicating essential information; coordinating actions; obtaining expert input; reviewing open issues and action items; contributing information to team meetings and reports; escalating project completion impediments.  Meets cost standards by preparing cost-benefit analyses; tracking and reporting expenses.
  • 24.

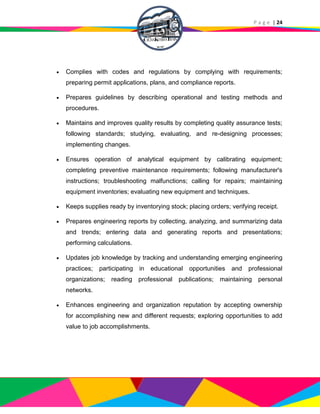

    P a ge | 24  Complies with codes and regulations by complying with requirements; preparing permit applications, plans, and compliance reports.  Prepares guidelines by describing operational and testing methods and procedures.  Maintains and improves quality results by completing quality assurance tests; following standards; studying, evaluating, and re-designing processes; implementing changes.  Ensures operation of analytical equipment by calibrating equipment; completing preventive maintenance requirements; following manufacturer's instructions; troubleshooting malfunctions; calling for repairs; maintaining equipment inventories; evaluating new equipment and techniques.  Keeps supplies ready by inventorying stock; placing orders; verifying receipt.  Prepares engineering reports by collecting, analyzing, and summarizing data and trends; entering data and generating reports and presentations; performing calculations.  Updates job knowledge by tracking and understanding emerging engineering practices; participating in educational opportunities and professional organizations; reading professional publications; maintaining personal networks.  Enhances engineering and organization reputation by accepting ownership for accomplishing new and different requests; exploring opportunities to add value to job accomplishments.
  • 25.
    P a ge | 25 Qualifications  Male/Female, 20-28 years old  Graduate of Industrial Engineering , Civil, Mechanical Engineering or any related course  With knowledge in Analyzing Information , General Math Skills, Reporting Research Results, Dealing with Complexity, Presentation Skills, Verbal Communication, Written Communication, Drafting, Analytical Tools, Attention to Detail, Innovation or any related  No experience required  Willingness to learn  FINANCIAL PLANNER Job Description  Defines financial situtation by completing quantitative analyses.  Evaluates optional plans by identifying outcomes and potential returns.  Values assets by appraising current condition; assessing potential.  Recommends debt structures by analyzing refinancing options.  Builds financial database by identifying sources of information; assembling, verifying, and backing up data.  Accomplishes organization goals by accepting ownership for accomplishing new and different requests; exploring opportunities to add value to job accomplishments.  Updates job knowledge by participating in educational opportunities; reading professional publications; maintaining personal networks; participating in professional organizations.
  • 26.

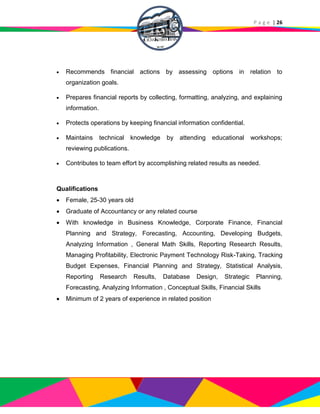

    P a ge | 26  Recommends financial actions by assessing options in relation to organization goals.  Prepares financial reports by collecting, formatting, analyzing, and explaining information.  Protects operations by keeping financial information confidential.  Maintains technical knowledge by attending educational workshops; reviewing publications.  Contributes to team effort by accomplishing related results as needed. Qualifications  Female, 25-30 years old  Graduate of Accountancy or any related course  With knowledge in Business Knowledge, Corporate Finance, Financial Planning and Strategy, Forecasting, Accounting, Developing Budgets, Analyzing Information , General Math Skills, Reporting Research Results, Managing Profitability, Electronic Payment Technology Risk-Taking, Tracking Budget Expenses, Financial Planning and Strategy, Statistical Analysis, Reporting Research Results, Database Design, Strategic Planning, Forecasting, Analyzing Information , Conceptual Skills, Financial Skills  Minimum of 2 years of experience in related position
  • 27.
    P a ge | 27  HUMAN RESOURCE MANAGER Job Description  Maintains the work structure by updating job requirements and job descriptions for all positions.  Maintains organization staff by establishing a recruiting, testing, and interviewing program; counseling managers on candidate selection; conducting and analyzing exit interviews; recommending changes.  Prepares employees for assignments by establishing and conducting orientation and training programs.  Maintains a pay plan by conducting periodic pay surveys; scheduling and conducting job evaluations; preparing pay budgets; monitoring and scheduling individual pay actions; recommending, planning, and implementing pay structure revisions.  Ensures planning, monitoring, and appraisal of employee work results by training managers to coach and discipline employees; scheduling management conferences with employees; hearing and resolving employee grievances; counseling employees and supervisors.  Maintains employee benefits programs and informs employees of benefits by studying and assessing benefit needs and trends; recommending benefit programs to management; directing the processing of benefit claims; obtaining and evaluating benefit contract bids; awarding benefit contracts; designing and conducting educational programs on benefit programs.  Ensures legal compliance by monitoring and implementing applicable human resource federal and state requirements; conducting investigations; maintaining records; representing the organization at hearings.
  • 28.
    P a ge | 28  Maintains management guidelines by preparing, updating, and recommending human resource policies and procedures.  Maintains historical human resource records by designing a filing and retrieval system; keeping past and current records.  Maintains professional and technical knowledge by attending educational workshops; reviewing professional publications; establishing personal networks; participating in professional societies.  Completes human resource operational requirements by scheduling and assigning employees; following up on work results.  Maintains human resource staff by recruiting, selecting, orienting, and training employees.  Maintains human resource staff job results by counseling and disciplining employees; planning, monitoring, and appraising job results.  Contributes to team effort by accomplishing related results as needed. Qualifications  Candidate must possess at least a Bachelor’s/College Degree in Psychology or closely related field  Male/Female 25-30 years old  At least 2-3 years working experience in the related field  Ability to communicate effectively both written and verbally  With knowledge in Hiring, Human Resources Management, Benefits Administration, Performance Management, Communication Processes, Compensation and Wage Structure, Supports Diversity, Classifying
  • 29.
    P a ge | 29 Employees, Employment Law, Laws Against Sexual Harassment, Organization  HUMAN RESOURCE ADMINISTRATIVE ASSISTANT Job Description  Provides job candidates by screening, interviewing, and testing applicants; notifying existing staff of internal opportunities; maintaining personnel records; obtaining temporary staff from agencies.  Pays employees by calculating pay; distributing checks; maintaining records.  Administers student loan, medical insurance, savings bond, and disability programs by advising employees of eligibility; providing application information; helping with form completion; verifying submission; notifying employees of approvals.  Monitors unemployment claims by reviewing claims; substantiating documentation; requesting legal counsel review.  Maintains human resources records by recording new hires, transfers, terminations, changes in job classifications, merit increases; tracking vacation, sick, and personal time.  Orients new employees by providing orientation information packets; reviewing company policies; gathering withholding and other payroll information; explaining and obtaining signatures for benefit programs.  Documents human resources actions by completing forms, reports, logs, and records.  Updates job knowledge by participating in educational opportunities; reading professional publications.
  • 30.
    P a ge | 30  Accomplishes human resources department and organization mission by completing related results as needed. Qualifications  Candidate must possess at least a Bachelor’s/College Degree in Psychology or closely related field  Male/Female 20-30 years old  Ability to communicate effectively both written and verbally  No experience required  Willingness to learn  TRAIN OPERATOR/DRIVER Job Description  Checking equipment and engines before a journey starts  Contacting control centres for information about routes and any problems  Following signalling instructions during the journey  Making passenger announcements  Controlling automatic doors  Positioning and handing over engines to drivers on the next shift. Qualifications  High school diploma or equivalent.  Must be at least 21 years of age.  Professional driving experience within the last three years.  Experience may include, but not be limited to, previous operation of light rail vehicle, transit bus/school bus and/or truck. Not more than five (5) points assessed against motor vehicle record (MVR) in the past two (2) years as
  • 31.
    P a ge | 31 well as possessing a continually valid driver's license for the past two (2) years. Also no DUI, DWI, or reckless driving in the past 24 months.  Ability to pass a Department of Transportation (DOT) physical examination by obtaining a DOT Medical Examiner's Certificate for a minimum of a 2-year qualifying period and then maintain a current DOT Medical Examiner's Certificate thereafter.  Ability to pass a RTD required Physical Ability Asssessment (PAA) related to the physical requirements of the essential functions of the job.  Ability to obtain and maintain a current valid Colorado Commercial Driver's License with an air brake and passenger endorsement (Class B-P2). Ability to successfully complete the LRV Operator Training Program in order to be certified and retain a thorough understanding of all new rules and procedures which are in effect.  Ability to use prudent judgment and common sense in making quick, safe decisions with minimal supervision and adapt to constantly changing operating environments.  Ability to effectively communicate, both orally and in writing, while interacting with customers and RTD staff in a courteous, professional manner. This includes providing good customer service by attending to the needs of a diverse customer base in a sensitive manner.  Strong customer service skills.  Ability to read, write, and speak English. Demonstrated physical ability to perform job duties to include: throwing rail switches, accessing and operating LRV, operating accessibility ramp, coupling/uncoupling LRVs, and raising/lowering LRV pantograph.  Demonstrated ability to push/pull up to 125 pounds and lift/carry up to 60 pounds without assistance.
  • 32.
    P a ge | 32  Ability to walk on track ballast, on uneven ground, sit for an extended period of time, and work in various outdoor weather.  Ability to be re-certified periodically on standard operating procedures as well as through examination on all Rules and as hands-on proficiency. Ability to maintain a high performance level of dependability, reliability and safety as demonstrated in the past six (6) months by: o -No more than three (3) occurrences and three (3) tardies. o -No more than eighty (80) hours unscheduled work absences. o -Extenuating circumstances will be reviewed.  Acceptable driving record as demonstrated in the past six (6) months by: o -No 'at-fault' of Class A or B safety violations. o -No suspensions for violations of rules or operating procedures  Ability to work unusual hours, split shifts, weekends, holidays, and overtime as required.  CONSTRUCTION SUPERVISOR/ESTIMATOR Job Description  Accomplishes construction human resource objectives by selecting, orienting, training, assigning, scheduling, coaching, counseling, and disciplining employees; communicating job expectations; planning, monitoring, appraising job contributions; recommending compensation actions; adhering to policies and procedures.  Manages sub-contractors by locating, evaluating, and selecting sub- contractors; monitoring and controlling performance.  Meets operational standards by contributing construction information to strategic plans and reviews; implementing production, productivity, quality,
  • 33.
    P a ge | 33 and customer-service standards; resolving problems; identifying construction management system improvements.  Meets construction budget by monitoring project expenditures; identifying variances; implementing corrective actions; providing non-project annual operating and capital budget information.  Accomplishes construction project results by defining project purpose and scope; calculating resources required; establishing standards and protocols; allocating resources; scheduling and coordinating staff and sub-contractors; evaluating milestone assumptions and conclusions; resolving design problems; evaluating and implementing change orders.  Approves construction projects by conducting inspections at critical phases; obtaining approvals from buyers.  Prevents fines and interruptions by complying with, and enforcing, codes.  Maintains safe, secure, and healthy work environment by following and enforcing standards and procedures; complying with legal regulations.  Updates job knowledge by tracking and understanding emerging construction practices and standards; participating in educational opportunities; reading professional publications; maintaining personal networks; participating in professional organizations.  Enhances organization reputation by accepting ownership for accomplishing new and different requests; exploring opportunities to add value to job accomplishments.  Prepares work to be accomplished by gathering information and requirements; setting priorities.
  • 34.
    P a ge | 34  Prepares construction budget by studying home plans; updating specifications; identifying and projecting costs for each elevation.  Evaluates offers to purchase by costing changes, additions, and site requirements.  Obtains bids from vendors and subcontractors by specifying materials; identifying qualified subcontractors; negotiating price.  Maintains cost keys and price masters by updating information.  Resolves cost discrepancies by collecting and analyzing information.  Prepares special reports by collecting, analyzing, and summarizing information and trends.  Maintains quality service by following organization standards.  Maintains continuity among corporate, division, and local work teams by documenting and communicating actions, irregularities, and continuing needs.  Maintains professional and technical knowledge by attending educational workshops; reviewing professional publications; establishing personal networks; participating in professional societies.  Contributes to team effort by accomplishing related results as needed. Qualifications  Male, 25-35 years old  Graduate of Civil, Mechanical Engineering, Architecture or any related course  With knowledge in Project Management, Quality Management, Supervision, Managing Profitability, Delegation, Supply Management, ADA Requirements, Civil Project Management, Estimating, Attention to Detail, Quality Focus or any related
  • 35.
    P a ge | 35  Minimum of 2 years of experience in related position  TICKET OPERATOR Job Description  Responsible for selling tickets to customers  Responsible reporting daily sales and bookkeeping Qualifications  Must be at least high school graduate  Female, 18-30 years old  Service oriented and hardworking  Good customer communication and service skills  SECURITY GUARD Job Description  Maintains security and safety of people and property in assigned area on company by patrolling areas on foot and enforcing company rules and regulation. Qualifications  Candidate must possess at least a Vocational Diploma / Short Course Certificate, Protective Services & Management or equivalent.  At least 2 year(s) of working experience in the related field is required for this position.  Applicants must be willing to work on any shift.  Male, 25 - 40 years old
  • 36.
    P a ge | 36  MAINTENANCE PERSONNEL (JANITOR/JANITRESS) Job Description  Sweep and mop floors.  Cleaning trains and stations by emptying trash, sweeping, and cleaning surfaces.  Clean and disinfect laboratory equipment.  Monitor establishment’s security and safety by performing such tasks as locking doors after operating hours and checking electrical appliance use to ensure that hazards are not created.  Use cleaning solutions to remove stains and clean surfaces.  Mix various cleaning agents.  Clean windows, glass partitions, and mirrors, using soapy water or other cleaners, sponges, and squeegees.  Clean and service restrooms with mops and disinfectants.  Identify and report possible repairs. Qualifications  Must be at least high school graduate  Female, 18-30 years old  Service oriented and hardworking  Must be flexible and willing to work to any assigned shift  Good customer service skills
  • 37.
    P a ge | 37 MANAGEMENT POLICIES AND PROCEDURES Every Policies and procedures are a vital part of business management because it provides a baseline of internal control allows employees to understand their roles and responsibilities within predefined limits. Basically, policies & procedures allow management to guide operations without constant management intervention. There are some conditions unique in our business which the employees cannot be expected to know about unless the management calls their attention. o Employees are expected to devote his/her time and energy toward the performance of the duties and responsibilities assigned to him/her, which may be changed at any time from time to time. o Business transaction not related to work is prohibited within company premises. o All employees are entitled to receive 60 minutes or 1 hour break daily. o Smoking while on duty and in unauthorized places are prohibited. Neatness and Uniform Policy o Men are not allowed to grow their mustache and stubbles should be shaving as soon as noticeable. o All employees should wear proper uniform according to the rules. Employees must wear company uniform every Monday, and Wednesday; and during field work. Employees must wear casual attire every Tuesday, and Thursday. Employees are free to use anything they desire to wear as long as it is presentable. o All employees should have clean hands and short fingernails. Duty to Report/ Failing to Call
  • 38.
    P a ge | 38 o All employees have a duty to report any violations of the company policies and procedures and while they initially be reluctant to get involved, it’s important to note that failure to report violations can have substantial consequences. In addition to the possibility of being held personally liable for the legal or ethical violation, they may subject to disciplinary proceedings, including termination, so when in doubt they should speak up. Rules of Conduct o Employees are required to obey instructions and perform works as required or assigned. Any insubordination or failure to obey lawful instructions with regard to work and behavior will result to disciplinary action. o Employees should respect the person, rights and properties of all who work with them, particularly our customers. Acts of, or even attempts to cause physical or psychological harm, injury, damage, loss and situations to endanger safety well- being of the above stated persons will be subjected to disciplinary action. o Employees are not allowed to leave the job without permission or conduct personal affair while on duty. Security Policies To further protect the company premises and employees working here, the following guidelines have been set: o All employees (on duty or not) shall have their bags inspected by the security personnel before going in and when coming out. o All items take out from the company office and business establishment should be presented to the security personnel. o All employees are oblige to follow the building’s rules and policies.
  • 39.
    P a ge | 39 o Safety and security is a major concern for the company because it values its employees and customer not only for productivity but for humanity. The enterprise will be complying on different occupational safety and health regulations and programs mandated by different government agencies. Fire alarm, extinguishers and other safety measures will be placed in different areas of the establishment Drug Abuse Prevention Policy and Procedure Because of the harmful effects of drug abuse on the physical and well- being of its employee, the company is committed to maintain a drug free environment. In keeping with this commitment, drug abuse is hereby prohibited in any form. The company’s policy is to employ a work force free from use of dangerous drugs, either on or off the job. It is, therefore, the company policy that an employee found with the presence of dangerous drugs in his/her system, in possession of, using, selling, trading or offering for sale dangerous drugs during work hours or company sponsored activities or on company’s premises, vehicles and the like may be subject to disciplinary action. Confidential Information In consideration for providing the employee with confidential information, the employee shall hold and treat all confidential information in strict confidence and will not disclose in any manner whatsoever, in whole or in part and will not use the confidential information without the company’s prior written the consent.
  • 40.
    P a ge | 40 EMPLOYEE LEAVING RIGHTS 1. Service Incentive Leave Under Article 95 of the Labor Code of the Philippines, an employee who has rendered at least (1) one year of service in a company is entitled to five (5) days leave of absence, with pay, every year. The phrase “one year of service” of the employee means service within twelve (12) months, whether continuous or broken, reckoned from the date the employee started working. The period includes authorized absences, unworked weekly rest days, and paid regular holidays. If through individual or collective agreement, company practice or policy, the period of the working days is less than twelve (12) months, said period shall be considered as one year for the purpose of determining the entitlement to the service incentive leave. The service incentive leave may be used for sick and vacation leave purposes. The unused service incentive leave is commutable to its money equivalent at the end of the year. 2. Maternity Leave This benefit applies to all female members, whether married or unmarried, of the Social Security System (SSS) who has paid at least 3 monthly contributions in the twelve-month period immediately preceding the semester of her childbirth or miscarriage. Members will be entitled to maternity leave benefit of sixty (60) days in case of normal delivery or miscarriage, or seventy-eight (78) days, in case of Caesarian section delivery, with benefits equivalent to one hundred percent (100%) of the average daily salary credit of the employee as defined under the law.
  • 41.
    P a ge | 41 3. Paternity Leave Paternity Leave is granted to all married male employees of a company. The purpose of this benefit is to allow the husband to lend support to his wife during her period of recovery and/or in nursing her newborn child. Usage of Paternity Leave shall be after the delivery. The paternity leave shall be for seven (7) calendar days, with full pay, consisting of basic salary and mandatory allowances fixed by the Regional Wage Board, if any, provided that his pay shall not be less than the mandated minimum wage. 4. Parental Leave for Solo Parent Under RA 8972, Parental leave is a benefit granted to a solo parent to enable him/her to perform parental duties and responsibilities where physical presence is required. Employees that are considered as a solo parent and who have rendered service of at least (1) one year to a company are entitled to 7 working days of leave. 5. Leave for Victims of Violence against Women and their Children Based From RA 9262, Employees who fall under the definition of “Victims of Violence against women and their children “or otherwise known as Republic Act 9262 and who have submitted a certification of violence shall be entitled a leave of ten (10) days with full pay, consisting of basic salary and mandatory allowances . The leave benefit shall cover the days that the woman employee has to attend to medical and legal concerns. 6. Sick Leave Employees should have reasonable opportunities for time away from work without loss of pay to handle illness, injury, legal quarantine and attending visits with health care providers for themselves and immediate family members and
  • 42.
    P a ge | 42 members of their household who are dependent upon them for care during illness or injury. Full-time employees shall accrue seven and one-half (7.5) hours of sick leave for each two (2) months of employment and an additional seven and one-half (7.5) hours of sick leave for each four (4) months of employment. 7. Special Leave for Women RA 9710 is an article for Special Leave for women. Special Leave is granted to female employees, regardless of age and civil status, with Gynecological disorders and who have rendered at least six (6) months continuous aggregate employment service for the last twelve (12) months prior to surgery. The employee shall be entitled of (2) two months leave with full pay based on her gross monthly compensation. 8. Vacation Leave Under a Vacation Leave, each full-time employee shall be given 5 paid working days (40 hours) vacation at the end of the first year of continuous employment and 10 paid working days (80 hours) vacation at the end of the second year of continuous employment. After 5 years of continuous employment, full-time employees will be eligible for 15 paid working days (120 hours) vacation. Vacation leave may only be used in ½ day or whole day increments. Termination / Employee Dismissal Termination occurs when an employer or employee ends an employee's employment with a particular employer. Termination can be voluntary or involuntary depending on the circumstances.
  • 43.
    P a ge | 43 In other instances of employment termination, the employment is terminated for a reason which is given to the employee and stated in the termination letter. Termination for cause can occur in such situations as: o Violation of the company code of conduct or ethics policy, o Unacceptable Personal Conduct o Unsatisfactory Job Performance o Failure to follow company policy, o Violence or threatened violence, o Gross and habitual neglect of duty, o Fraud, o Commission of a crime, o Extreme insubordination, o Sexual harassment, or o Watching pornography online Resignation from work will only take effect fifteen days after submission of resignation letter and after the resigning employee complies with the company clearance on accountabilities. SALARIES AND WAGES Monthly Salary Minimum wage is given to direct and indirect employees, wages is according to the Department of Labor and Employment: National Wages and Productivity Commission, underlying the sector of Service, with 16 or more than number of employees. Each classified position is assigned to a salary range that provides, based on similar employment in the defined labor market: minimum, mid-point, and maximum salary rates that are competitive with rates in the external labor market consistent with
  • 44.
    P a ge | 44 the Enterprise’ ability to pay; and proper relationships within State government employment to maintain internal equity. Employees such as, Janitors, Construction Workers, Ticket Operators, and Security Guard will be paid in accordance to their hourly rate. Direct employees will work 8 hours daily with 1 hour break, and an overtime if needed. Computation of Minimum Wage (Maintenance Personnel, Ticket Operator, and Security Guard) Minimum wage: PHP 451.00 Cost of Living Allowance: PHP 15.00 Rate per day: (Wage/per day)+COLA= 451+15 = PHP 466.00 Annual Gross Salary The annual gross salary of employees of GRT Corporation is consisting of annual salary of an employee before deductions are made plus the 13th month pay. GRT Corporation has different approach of the salary computation depending on the working days of employees. Administrative or Office Employees have only 5 working days a week or a total of 270 days a year depending on the status of the project, and for field workers/employees a total of 324 working days in a year. Every employee will also receive a thirteenth month pay equivalent to their monthly salary pay. GRT Corporation will be allotting PHP 17,002,400.00 as the total salaries of its employees per annum, inclusive of the thirteenth month pay.
  • 45.
    P a ge | 45 Compensation It’s a policy of the company to compensate its employees at a level sufficient to encourage excellence of performance and to maintain the labor market competitiveness necessary to recruit and retain a competent work force. The pay period of GRT Corporation will be the usual cut-off which is on the 15th and 30th day of the month. Employees are required to give the company their bank account numbers to be able to conduct salary payments through bank transactions. As for the construction labors, their salary or pay period will be on a weekly basis. Work Pay The minimum wage would be PHP 451.00 and integration of the P15 COLA under W.O. No. NCR-17 into the basic pay which sums up to PHP 466.00 Basic Pay GRT Company basic payments will be ranging from the minimum wage of Php 430.00 to PHP 1,360.00 per day. Wage rates of the employees will vary due to the extent of their responsibilities and the degree of educational attained. Fringe Benefits 1. Employees are entitled to 13th month pay and bonuses one year after the business has established. 2. Employees are entitled of a separation pay under article 283-284 of the labor Code of the Philippines depending on the grounds of the company’s termination policy. 3. Promotion opportunity – this is offered to employees who are excellent performers, shows initiative and desire to advance. High rates of pay are given for these extra responsibilities.
  • 46.
    P a ge | 46 4. Philhealth – the Philhealth program provides benefits for the hospitalization of the employees. 5. SSS Benefits – a social security contribution is required to include both the employer and employees share. Overtime Pay Overtime pay refers to the additional compensation for work performed beyond eight (8) hours a day Back Pay Back Pay is past wages and benefits (bonus, increment, overtime, etc.) to which an employee is entitled either because of a retroactive increase or employment practices (such as dismissal or denial of promotion) declared unlawful by a court or tribunal.HR automatically deletes employee name from the payroll and therefore not paid for the days worked from previous payroll to the day to resign. The pay computed manually which sometimes takes a while because it has to be verified and approved by the management.
  • 47.
    P a ge | 47 SALARY BREAKDOWN EMPLOYEE'S BASIC SALARY ANNUAL SALARY POSITION EMPLOYE E # HOURLY RATE DAILY RATE BASIC SALARY 2015 2016 2017 2018 2019 2020 Administrative Labor 3 Stations 6 Stations 9 Stations General Manager 1 166.67 1,333.3 3 40,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 Operations Engineer 1 137.50 1,100.0 0 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 Project Engineer 1 137.50 1,100.0 0 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 Assistant Engineer 1 95.83 766.67 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 Construction Supervisor/Estimator 1 137.50 1,100.0 0 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 HR Manager 1 116.67 933.33 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 HR Administrative Assistant 1 95.83 766.67 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 Financial Planning Analysts 1 116.67 933.33 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 Direct Labor Ticket Operator 36 58.25 466.00 13,980.00 2,013,120.0 0 4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00 Train Driver 9 62.50 500.00 15,000.00 540,000.00 1,080,000.00 1,620,000.00 1,620,000.00 1,620,000.00 Indirect Labor Security Guards 36 58.25 466.00 13,980.00 2,013,120.0 0 4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00 Janitors/Janitress 36 58.25 466.00 13,980.00 2,013,120.0 0 4,026,240.00 9,772,020.00 6,039,360.00 6,039,360.00 TOTAL 125 1,241.4 2 9,931.3 3 297,940.0 0 2,892,000.0 0 9,471,360.0 0 16,050,720.0 0 33,828,060.0 0 22,630,080.0 0 22,630,080.0 0 Table 1.1 Employee’s Basic Salar
  • 48.
    P a ge | 48 ANNUAL PROJECTION OF EMPLOYEE'S SALARIES POSITION EMPLOYEE # BASIC SALARY 2015 2016 2017 2018 2019 2020 Administrative Labor 3 Stations 6 Stations 9 Stations General Manager 1 40,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 480,000.00 Operations Engineer 1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 Project Engineer 1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 Assistant Engineer 1 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 Construction Supervisor/Estimator 1 33,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 396,000.00 HR Manager 1 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 HR Administrative Assistant 1 23,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 276,000.00 Financial Planning Analysts 1 28,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 336,000.00 Direct Labor Ticket Operator 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00 Train Driver 9 15,000.00 540,000.00 1,080,000.00 1,620,000.00 1,620,000.00 1,620,000.00 Indirect Labor Security Guards 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00 Janitors/Janitress 36 13,980.00 2,013,120.00 4,026,240.00 6,039,360.00 6,039,360.00 6,039,360.00 TOTAL 125 297,940.00 2,892,000.00 9,471,360.00 16,050,720.00 22,630,080.00 22,630,080.00 22,630,080.00 Table 1.2 Annual Projection of Employee’s Salary
  • 49.
    P a ge | 49 EMPLOYEE'S 13th MONTH PAY POSITION EMPLOYEE # BASIC SALARY 2015 2016 2017 2018 2019 2020 Administrative Labor 3 Stations 6 Stations 9 Stations General Manager 1 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00 40,000.00 Operations Engineer 1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 Project Engineer 1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 Assistant Engineer 1 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 Construction Supervisor/Estimator 1 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 33,000.00 HR Manager 1 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 HR Administrative Assistant 1 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 23,000.00 Financial Planning Analysts 1 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 28,000.00 Direct Labor Ticket Operator 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00 Train Driver 9 15,000.00 45,000.00 90,000.00 135,000.00 135,000.00 135,000.00 Indirect Labor Security Guards 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00 Janitors/Janitress 36 13,980.00 167,760.00 335,520.00 503,280.00 503,280.00 503,280.00 TOTAL 125 297,940.00 241,000.00 789,280.00 1,337,560.00 1,885,840.00 1,885,840.00 1,885,840.00 Table 1.3 Employee’s 13th Month Pay
  • 50.
    P a ge | 50 SALARY WITH DEDUCTIONS Salary deductions are mandated fees collected by the government. These are deductions collected from the employee's income and are used to give benefits and loans to employees. GRT Corporation will be participating in this legal responsibilities to ensure the future of its employees.  SSS or the Social Security System is one of the deductions in employee's income. The collected deduction from employees is submitted to the Social Security system. The fees collected from the employees are accumulated, and in time mandated by the government agency, loans are made available to members.  Philhealth Contribution is another contribution collected from the employees. These contributions are intended for the employee's health welfare. When emergency times come, Philhealth provides discounts and medical benefits to help in employee's medical needs.  Pag-ibig fund contribution is also deducted from employee's salary. In return, employees are given loan privileges for housing purposes.  Withholding Taxes Withholding taxes are individual taxes coming from each employee. These taxes are given to the government. The percentage of deduction for each employee will be based on the individual's salary as well on the number qualified dependents. o Net pay of labors are the amount that retained in the salary of the workers after the deduction from SSS, Philhealth, Pag-ibig, and Withholding Tax are made.
  • 51.
    P a ge | 51 EMPLOYEES BASIC SALARY WITH DEDUCTIONS POSITION BASIC SALARY GROSS PAY DEDUCTIONS NET PAY SSS CONTRIBUTIO N PHILHEALTH CONTRIBUTIO N PAG-IBIG CONTRIBUTIO N WITHOLDIN G TAX Administrative Labor General Manager 40,000.00 40,000.00 581.30 437.50 800.00 8,331.03 29,850.17 Operations Engineer 33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67 Project Engineer 33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67 Assistant Engineer 23,000.00 23,000.00 581.30 287.50 460.00 3,424.55 18,246.65 Construction Supervisor/Estimator 33,000.00 33,000.00 581.30 412.50 660.00 6,238.53 25,107.67 HR Manager 28,000.00 28,000.00 581.30 350.00 560.00 4,757.28 21,751.42 HR Administrative Assistant 23,000.00 23,000.00 581.30 287.50 460.00 3,424.55 18,246.65 Financial Planning Analysts 28,000.00 28,000.00 581.30 350.00 560.00 4,757.28 21,751.42 Direct Labor Ticket Operator 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71 Train Driver 15,000.00 15,000.00 545.00 187.50 300.00 1,514.57 12,452.93 Indirect Labor Security Guards 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71 Janitors/Janitress 13,980.00 13,980.00 508.70 162.50 100.00 1,350.09 11,858.71 TOTAL 297,940.0 0 297,940.0 0 6,721.50 3,625.00 5,420.00 48,975.12 233,198.3 8 Table 2.1 Employee’s Basic Salary Deductions
  • 52.
    P a ge | 52 EMPLOYEE'S SSS CONTRIBUTION POSITION EMPLOYEE # BASIC SALARY SSS MONTHLY CONTRIBUTION 2015 2016 2017 2018 2019 2020 Administrative Labor General Manager 1 40,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Operations Engineer 1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Project Engineer 1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Assistant Engineer 1 23,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Construction Supervisor/Estimator 1 33,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 HR Manager 1 28,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 HR Administrative Assistant 1 23,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Financial Planning Analysts 1 28,000.00 581.30 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 6,975.60 Direct Labor Ticket Operator 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40 Train Driver 9 15,000.00 545.00 19,620.00 39,240.00 58,860.00 58,860.00 235,440.00 Indirect Labor Security Guards 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40 Janitors/Janitress 36 13,980.00 508.70 73,252.80 146,505.60 219,758.40 219,758.40 219,758.40 TOTAL 125 297,940.00 55,804.80 295,183.20 534,561.60 773,940.00 773,940.00 950,520.00 Table 2.3 Employee’s SSS Contribution
  • 53.
    P a ge | 53 EMPLOYER'S SSS CONTRIBUTION POSITION EMPLOYE E # BASIC SALARY SSS MONTHLY CONTRIBUTIO N 2015 2016 2017 2018 2019 2020 Administrative Labor General Manager 1 40,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Operations Engineer 1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Project Engineer 1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Assistant Engineer 1 23,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Construction Supervisor/Estimator 1 33,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 HR Manager 1 28,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 HR Administrative Assistant 1 23,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Financial Planning Analysts 1 28,000.00 1,178.70 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 14,144.40 Direct Labor Ticket Operator 36 13,980.00 1,031.30 148,507.2 0 297,014.40 445,521.60 445,521.60 445,521.60 Train Driver 9 15,000.00 1,105.00 39,780.00 79,560.00 119,340.00 119,340.00 477,360.00 Indirect Labor Security Guards 36 13,980.00 1,031.30 148,507.2 0 297,014.40 445,521.60 445,521.60 445,521.60 Janitors/Janitress 36 13,980.00 1,031.30 148,507.2 0 297,014.40 445,521.60 445,521.60 445,521.60 TOTAL 125 297,940.0 0 113,155.2 0 598,456.8 0 1,083,758.4 0 1,569,060.0 0 1,569,060.0 0 1,927,080.0 0 Table 2.4 Employer’s SSS Contribution
  • 54.
    P a ge | 54 EMPLOYEE'S PHILHEALTH CONTRIBUTION POSITION EMPLOYEE # BASIC SALARY PHILHEALTH MONTHLY CONTRIBUTION 2015 2016 2017 2018 2019 2020 Administrative Labor General Manager 1 40,000.00 437.50 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 Operations Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 Project Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 Assistant Engineer 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 Construction Supervisor/Estimator 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 HR Manager 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 HR Administrative Assistant 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 Financial Planning Analysts 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 Direct Labor Ticket Operator 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 Train Driver 9 15,000.00 187.50 6,750.00 13,500.00 20,250.00 20,250.00 81,000.00 Indirect Labor Security Guards 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 Janitors/Janitress 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 TOTAL 125 297,940.00 35,400.00 112,350.00 189,300.00 266,250.00 266,250.00 327,000.00 Table 2.6 Employee’s PhilHealth Contribution
  • 55.
    P a ge | 55 EMPLOYER'S PHILHEALTH CONTRIBUTION POSITION EMPLOYEE # BASIC SALARY PHILHEALTH MONTHLY CONTRIBUTION 2015 2015 2016 2017 2018 2019 Administrative Labor General Manager 1 40,000.00 437.50 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 5,250.00 Operations Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 Project Engineer 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 Assistant Engineer 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 Construction Supervisor/Estimator 1 33,000.00 412.50 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 4,950.00 HR Manager 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 HR Administrative Assistant 1 23,000.00 287.50 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 3,450.00 Financial Planning Analysts 1 28,000.00 350.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 4,200.00 Direct Labor Ticket Operator 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 Train Driver 9 15,000.00 187.50 6,750.00 13,500.00 20,250.00 20,250.00 81,000.00 Indirect Labor Security Guards 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 Janitors/Janitress 36 13,980.00 162.50 23,400.00 46,800.00 70,200.00 70,200.00 70,200.00 TOTAL 125 297,940.00 35,400.00 112,350.00 189,300.00 266,250.00 266,250.00 327,000.00 Table 2.6 Employer’s PhilHealth Contribution
  • 56.
    P a ge | 56 EMPLOYEE'S PAG-IBIG CONTRIBUTION POSITION EMPLOYEE # BASIC SALARY PAG-IBIG MONTHLY CONTRIBUTION 2015 2015 2016 2017 2018 2019 Administrative Labor General Manager 1 40,000.00 800.00 9,600.00 9,600.00 9,600.00 9,600.00 9,600.00 9,600.00 Operations Engineer 1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 Project Engineer 1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 Assistant Engineer 1 23,000.00 460.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 Construction Supervisor/Estimator 1 33,000.00 660.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 7,920.00 HR Manager 1 28,000.00 560.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 HR Administrative Assistant 1 23,000.00 460.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 5,520.00 Financial Planning Analysts 1 28,000.00 560.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 6,720.00 Direct Labor Ticket Operator 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00 Train Driver 9 15,000.00 300.00 10,800.00 21,600.00 32,400.00 32,400.00 129,600.00 Indirect Labor Security Guards 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00 Janitors/Janitress 36 13,980.00 100.00 14,400.00 28,800.00 43,200.00 43,200.00 43,200.00 TOTAL 125 297,940.00 57,840.00 111,840.00 165,840.00 219,840.00 219,840.00 317,040.00 Table 2.7 Employee’s PAG-IBIG Fund Contribution
  • 57.
    P a ge | 57 EMPLOYEE'S WITHOLDING TAX POSITION EMPLOYE E # BASIC SALARY MONTHLY WITHOLDIN G TAX 2015 2016 2017 2018 2019 2020 Administrative Labor General Manager 1 40,000.00 8,331.03 99,972.36 99,972.36 99,972.36 99,972.36 99,972.36 99,972.36 Operations Engineer 1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 Project Engineer 1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 Assistant Engineer 1 23,000.00 3,424.55 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 Construction Supervisor/Estimator 1 33,000.00 6,238.53 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 74,862.36 HR Manager 1 28,000.00 4,757.28 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 HR Administrative Assistant 1 23,000.00 3,424.55 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 41,094.60 Financial Planning Analysts 1 28,000.00 4,757.28 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 57,087.36 Direct Labor Ticket Operator 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88 Train Driver 9 15,000.00 1,514.57 54,524.52 109,049.04 163,573.56 163,573.56 654,294.24 Indirect Labor Security Guards 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88 Janitors/Janitress 36 13,980.00 1,350.09 194,412.96 388,825.92 583,238.88 583,238.88 583,238.88 TOTAL 125 297,940.0 0 520,923.3 6 1,158,686.7 6 1,796,450.1 6 2,434,213.5 6 2,434,213.5 6 2,924,934.2 4 Table 2.8 Employee’s Withholding Tax
  • 58.
    P a ge | 58 REGULAR PAID HOLIDAY Holiday Pay Holiday pay refers to the payment of the regular daily wage for any unworked regular holiday.Employees covered by the holiday pay rule are entitled to their basic wage for any non-working regular holiday. Employees who would be working for the said holiday will have a double pay. Pursuant to the provisions of the Labor Code, as amended in relation to the observance of declared holidays and in response to the queries received every time a Presidential Proclamation or a law is enacted by Congress which declares certain days either as a regular holiday, a special day or a special working holiday, the following guidelines shall be observed by all employers in the private sector: Unless otherwise modified by law, order, or proclamation, the following are the twelve (12) regular holidays in a year under Executive Order No. 292, as amended by Republic Act 9849: o New Year’s Day - January 1 o Maundy Thursday - Movable Date o Good Friday - Movable Date o Araw ng Kagitingan - April 9 o Labor Day - May 1 o Independence Day - June 12 o National Heroes’ Day - Last Monday of August o Bonifacio Day - November 30 o Eid’l Fitr - Movable Date o Eid’l Adha - Movable Date o Christmas Day - December 25 o Rizal Day - Monday nearest December 30
  • 59.
    P a ge | 59 The following rules shall apply: 1. If it is an employee’s regular workday o If unworked – 100% o If worked:  1st 8 hours – 200%  excess of 8 hours – plus 30% of hourly rate on said day 2. If it is an employee’s rest day o If unworked – 100% o If worked  1st 8 hours – plus 30% of 200%  excess of 8 hours – plus 30% of hourly rate on said day Premium Pay Premium pay refers to the additional compensation for work performed within eight (8) hours on non-work days, such as rest days and special days. Unless otherwise modified by law, order, or proclamation, the following are the three (3) special days in a year under Executive Order No. 292, as amended by Republic Act 9849 that shall be observed in the Philippines: o Ninoy Aquino Day - August 21 o All Saints Day - November 1 o Last Day of the Year - December 31 The following rules shall apply: 1. If unworked o No pay, unless there is a favorable company policy, practice or collective bargaining agreement (CBA) granting payment of wages on special days even if unworked.
  • 60.
    P a ge | 60 2. If worked o 1st 8 hours – plus 30% of the daily rate of 100% o excess of 8 hours – plus 30% of hourly rate on said day o Falling on the employee’s rest day and if worked o 1st 8 hours – plus 50% of the daily rate of 100% o excess of 8 hours – plus 30% of hourly rate on said day For those declared as special working holidays, the following rules shall apply: o For work performed, an employee is entitled only to his basic rate. No premium pay is required since work performed on said days is considered work on ordinary working days. Professional Fee The company will have an On-Call CPA Consultant that will be paid PHP 8,000.00 quarterly. PROFESSIONAL FEE FOR ON-CALL CPA CONSULTANT 2015 2016 2017 2018 2019 Annual Gross Pay 32,000.00 32,960.00 33,948.80 34,967.26 36,016.28 Withholding Tax 11,317.56 11,657.09 12,006.80 12,367.00 12,738.01 Annual Net Pay 20,682.44 21,302.91 21,942.00 22,600.26 23,278.27 Table 4.1 Professional Fee for On-Call CPA Consultant The company will hire a Construction Supervisor/Estimator until the project (rebuilding of Northrail transit which is from Tutuban, Manila to Dagupan, Pangasinan) is complete which is projected to be done on 2018. He will be paid PHP 33,000.00 monthly.
  • 61.
    P a ge | 61 PROFESSIONAL FEE FOR CONSTRUCTION SUPERVISOR/ESTIMATOR 2015 2016 2017 2018 Annual Gross Pay 396,000.00 396,000.00 396,000.00 396,000.00 Deductions (SSS, Philhealth, Pag- ibig) 19,845.60 19,845.60 19,845.60 19,845.60 Withholding Tax 74,862.36 74,862.36 74,862.36 74,862.36 Annual Net Pay 301,292.04 301,292.04 301,292.04 301,292.04 Table 4.2 Professional Fee for Construction Supervisor/Estimator
  • 62.
    P a ge | 62 BUSINESS TIMELINE Prior to the actual business operation, it is part of the process to fulfill the necessary pre-operating requirements and the responsibilities. In order to do this, the company recognized organizational structure from selection of business supported with a feasibility study and the following company activities that will support the legality, manpower requirements, safe and engineered facility, competitiveness and strong market impact of the company. The proponents use Gantt chart to show the scheduling of company activities from selecting a business to be established up to the normal start of operation.
  • 63.
    P a ge | 63 BUSINESS TIMELINE ACTIVITY 2015 2015 201 6 2017 2018 JULY AUGUST SEPTEM BER OCTOBE R NOVEM BER DECEMBE R JANUARY FEBRUA RY 1 2 3 4 1 2 3 4 1 2 3 4 1 2 3 4 2014 - 2015 1 2015 - 2016 1 2017 - 2018 1 2 3 4 1 Selection of business. 2 Feasibility study of business. 3 Canvassing of office furniture, supplies, and equipment. 4 Registration of business. 5 Purchasing of office furniture, supplies, and equipment. 6 Hiring, orientation, and training of business administration and construction firm. 7 Reconstruction of establishment. 8 Start of operation. 9 Reconstruction of establishment. 8 Start of operation. 11 Reconstruction of establishment. 12 Regular operations.
  • 64.
    P a ge | 64 MANAGEMENT ASSUMPTIONS The following assumptions were made in order to compute the administrative expenses:  The proponents assume that there are 15 holidays in a year; 12 regular holidays and 3 special holidays under Executive Order No. 292 as amended by RA 9849.  The proponents based the SSS contribution of the employees on the current SSS Contribution table.  The proponents based the PhilHealth contribution of employees on the current PhilHealth Contribution Table.  The proponents used the fixed P 100.00 HDMF Contribution for minimum wage earner-employees only, and 2% rate of basic salary for others.  The proponents assume that in a year, there will be 3 stations that are built/finished and will be operational.
  • 65.
    P a ge | 65 MARKETING ASPECT
  • 66.
    P a ge | 66 Marketing Aspect The marketing aspect of the feasibility aspect will consider the major nature of business, service description, the marketplace and industrial analysis and the marketing strategy. Demand and supply will be analyzed to know the target market shares. Service Description Gicha Ressha Train Company manages Manila – Dagupan railroad which cover major towns: Bulacan, Pampanga, Tarlac and Pangasinan from Manila and vice versa. Our train will provide own comfortable seats and own air-condition. Quality and safety is guaranteed to the passengers in their whole trip. Upon entering the stations, there will be reliable security guards roaming around and responsible to provide quality customer service that they need. Ticket vending machines and ticket booths are available to easy access magnetic card train ticket. To further increase customer satisfaction, the company is assured that passengers are at ease in traveling. Gicha Ressha Train (GRT) will strive to build a loyal customer service by offering a great facility during waiting and during the ride from Manila to Dagupan City. Market Comparison Buses will be the direct competitors of Manila – Dagupan Railroad base on routes. Presently, they are the one providing transportation for passengers who to travel to Northern Luzon.
  • 67.
    P a ge | 67 Industry Analysis Philippines’ railroad transportation can be considered as a developing mode of transportation. Picture below shows (fig. 1) the growing phase of railroad transportation. However, most of the routes are only in inter-city. Figure 4 Transit System Map
  • 68.
    P a ge | 68 According to the National Statistical Coordination Board (NSCB) in 2009, 74.7% of the population belongs to low – income class family that earns an average of P9,061 per month. They can’t afford to buy luxury goods like cars, apple gadgets and etc. During peak seasons: Holy Week, All Saint’s Day, All Souls Day, Christmas and New Year, normally people travel to provinces. As of now, buses are usually used mode of transportation that travels to Northern Luzon. A bus has a normal capacity of 50 or more seats for passengers. Figure 2 shows how frequently people travel to Northern Luzon using bus. 35% went to their provinces once a month. 28.05% said they travel to Northern Luzon once a year. 20.50% of the population travels every week. 16% travel seldom, occasionally, twice or thrice a year. Base on buses fare, Manila to Dagupan back and forth in ordinary bus is 552 and 700 pesos back and forth in air – conditioned buses. Passengers usually encounter 20.50% 35% 28.50% 16% Every Week Once a month Once a year Others Figure 5 Percentage of how often people travel using bus
  • 69.
    P a ge | 69 problems such as high fare, traffic, sudden malfunction, long waiting time, accidents and long travel time. Bus Travel Time From To Distance Time Via With Traffic No Traffic Cubao Bocaue 26.1 km 2 hrs 1 hr 10min Sapang Palay-Sta Cruz D. Jose via Sta Maria Cubao Malolos 42.5 km 3 hrs 2h 34 min Baclaran- SM Fairview via Quezon Avenue and Manila - Banaue Cubao San Fernando 80.3 km 3hrs 2h 5 min Avenida - Balanga Cubao Angeles 92.8 km 3 hrs 2h 32 mins Avenida - Dau Cubao Capas 118.3 km 3 hrs 2 hr 30 mins Cubao - Tarlac Cubao Tarlac 131.5 km 4 hrs 3 hr 41 mins Espana Blvd - Candon City and Cubao Bayambang 179.9 km 6 hrs 5hr 41 mins Avenida - Baguio and Aurora Blvd - San Carlos City Cubao Dagupan 214 km 8 hrs 6hr 52 mins Avenida – Baguio And Cubao - Dagupan Table 1 Time Flow of Bus
  • 70.
    P a ge | 70 Figure 6 Bus in the Philippines with 50 seats Figure 7 Industrial Framework
  • 71.
    P a ge | 71 Market Analysis People using trains have shown steady growth. People traveling to Northern Luzon are the one who will the company foresee to serve. The total target population is 881,651. Location Population Percentage of Willing to Ride the train Total Tutuban 233,240 20.78% 183,240 Bocaue 86,994 5.69% 50,156 Malolos 112,375 10.48% 92,375 Capas 125,852 9.44% 83,211 Tarlac 143,600 14.70% 129,600 San Fernando 150,762 10.86% 95,762 Angeles 208,268 11.03% 97,268 Bayambang 111,521 6.07% 53,497 Dagupan 163,676 10.95% 96,542 Total 1,336,288 100.00% 881,651 To determine the projected population for years 2015 – 2019, an average growth rate of 1.90% was used. Table 15 shows the projected population for the next five years. Year Target Population 2015 898,402 2016 915,472 2017 932,866 2018 950,590 2019 968,652 Table 3 Projected Population Bus companies are currently the available and serving the market. For now, they have the ability of mass transportation going from Manila to Dagupan and vice versa. Table 2 Total Population for the Year 2014
  • 72.
    P a ge | 72 The proponents conducted a survey to 400 respondents that represent the total population if the target market. Slovin’s Formula was used to determine the sample size with 5% margin of error. For the computation of sample size, see appendices. Demand Analysis Figure 5 shows the mode of transportation used by passengers going to Northern Luzon. The research shows 85.50% of the population used buses. 8.75% responded that they travel using their private cars. 5.75% used jeepneys in going to Northern Luzon. 8.75% 85.50% 5.75% Cars Buses Jeepneys Figure 8 Mode of Transportation going to Northern Luzon
  • 73.
    P a ge | 73 Year Target Population % of Population who are willing to ride train Market Acceptability Potential Target Market Percentage Frequency Annual Demand Total Annual DemandEvery Week Once a month Once a year Others Every Week Once a month Once a year Others 2014 881,651 47.25% 71.25% 296,813.32 20.50% 35.00% 28.50% 16.00% 3,285,723.45 1,246,615.94 84,591.80 189,960.52 4,806,891.71 Table 4 Annual Demand for Manila - Dagupan Railroad Usag
  • 74.
    P a ge | 74 Table 4 shows the demand for railroad transportation in the year 2014; the potential target market is calculated by multiplying the target population to the percentage of population who are willing to use a train and market acceptability. Annual demand is the product of potential target market, percentage of how people often use bus and number of days. Finally, the total annual demand is obtained by adding all the annual demand for Manila – Dagupan Railroad usage. Table 5 Projected Demand of Train Passengers Year Target Population % of Population who are willing to ride train Market Acceptability Potential Target Market Percentage Frequency Annual Demand Total Annual DemandEvery Week Once a month Once a year Others Every Week (54) Once a month (12) Once a year (1) Others (4) 2015 898,402 47.25% 71.25% 302,452.77 20.50% 35.00% 28.50% 16.00% 3,348,152.19 1,270,301.64 86,199.04 193,569.77 4,898,222.65 2016 915,472 47.25% 71.25% 308,199.38 20.50% 35.00% 28.50% 16.00% 3,411,767.08 1,294,437.38 87,836.82 197,247.60 4,991,288.88 2017 932,866 47.25% 71.25% 314,055.16 20.50% 35.00% 28.50% 16.00% 3,476,590.66 1,319,031.69 89,505.72 200,995.30 5,086,123.37 2018 950,590 47.25% 71.25% 320,022.21 20.50% 35.00% 28.50% 16.00% 3,542,645.88 1,344,093.29 91,206.33 204,814.22 5,182,759.71 2019 968,652 47.25% 71.25% 326,102.63 20.50% 35.00% 28.50% 16.00% 3,609,956.15 1,369,631.06 92,939.25 208,705.69 5,281,232.15
  • 75.
    P a ge | 75 Supply Analysis Gicha Ressha Train Company is in the business in line with constructing railroad system. Within the location for the stations chose by the proponents, bus transportation services are the one that offer the same route as Manila – Dagupan line. On the other hand, the proponent thought an improved mass transportation that can provide a smooth ride. Bus companies will be the direct competitor within the area that the business will operate. These competitors are currently the provider of the said service. Supply is important to fulfill the demand of the people. Operating Hours No. of authorized Unit/s No. of passengers per bus Total no. of Passengers Annual Supply (365) Bus 16 219 50 10,950 3,996,750 Total 3,996,750 Table 6 Competitor's Supply in 2014 Figure 9 Projected Demand for Train Usage 4,700,000.00 4,800,000.00 4,900,000.00 5,000,000.00 5,100,000.00 5,200,000.00 5,300,000.00 5,400,000.00 2015 2016 2017 2018 2019
  • 76.
    P a ge | 76 Table 6 shows the annual competitor’s supply of buses in 2014. The proponents conducted a time and motion study to several bus terminals to compute for the annual supply. Result shows that total annual supply of buses for the year 2014 is 3,996,750. Projecting supply is a way of forecasting sales. This enables the business to decide on its production capacity and marketing strategies. Year Supply 2015 4,196,588 2016 4,406,417 2017 4,626,738 2018 4,858,075 2019 5,100,978 Table 7 Projected Competitor's Supply 2015 – 2019 Figure 10 Projected Competitor's Supply Supply
  • 77.
    P a ge | 77 Demand – Supply Analysis Demand Gap is equal to the number of potential customers less the supply of the competitors. Computation for the demand gap stems from the competitors’ capacity to supply the demand of the target market annually. Table 8, shows the computed demand gap and its percentage for the year 2014. Frequency Percentage Demand Gap 810,142 16.85% Competitors Supply 3,996,750 83.15% Total Demand 4,806,891.71 100.00% Table 8 Demand - Supply Gap 2014 16.85% 83.15% Demand Gap Bus Figure 11 Percentage of Competitor's Supply and Demand Gap The figure below shows the market share of GRT Company and competitor’s supply including the demand gap for the year 2014. The pie chart below shows that the demand gap is 16.85%
  • 78.
    P a ge | 78 2015 2016 2017 2018 2019 Competitor's Supply 4196587.5 4406416.875 4626737.719 4858074.605 5100978.335 Total Demand 4,898,223 4,991,289 5,086,123 5,182,760 5,281,232 Store Capacity 867,716 921,948 976,180 1,030,412 1,084,644 Market Share 86% 88% 91% 94% 97% Table 9 Market Share The projected demand is greater than the projected supply throughout the study time presentation. The market share of GRT Company is ascending which means that the business is feasible but still, it must think through and improve marketing strategies to satisfy demand. Year Sale – VAT Inclusive Sale – Vat Exclusive 2015 105,208,564.82 93,936,218.59 2016 193,410,591.30 172,688,027.94 2017 628,729,822.81 561,365,913.22 2018 635,017,121.04 566,979,572.35 2019 641,367,292.25 572,649,368.08 Table 9 Computed Sale for five years of operation
  • 79.
    P a ge | 79 Customer Analysis Passengers going to Northern Luzon are the traditional customers in the market for they are traveling by buses, cars and jeepneys. The target market was segmented according to location. The target market consists of passengers traveling to Bulacan, Pampanga, Tarlac and Pangasinan from Tutuban Manila and vice versa. Customers have different perceptions in availing a certain service. Some are convinced by advertisements. Others were persuaded by price, benefits and its standing in the market. Several are influenced by famous personality and some avail because they just need it. Figure 12 shows problem encountered by passengers when traveling by bus. Passengers commonly complain on high fare, traffic and sudden malfunction of vehicle 0 100 200 300 400 500 600 Traffic Sudden Malfunction High Fare Others Tally Figure 12 Problems encountered of passengers when traveling
  • 80.
    P a ge | 80 (bus). Others were bothered of long waiting time, difficult to find a bus when rush hour, long traveling time and bus accidents. Target Market Strategy Quality and safety traveling are the priorities of our services. Since there is already a railroad track from Tutuban to Dagupan, our primary target market will be the passengers going from Manila to Bulacan, Pampanga, Tarlac and Pangasinan and vice versa for leisure or business purposes. Based on surveys, passengers encounter several problems when traveling like traffic, sudden malfunction of vehicle, high fare, long waiting time, difficult to find a bus when rush hour, long traveling time and bus accidents. These problems portray the needs of the customers. Gicha Ressha Train Company will endorse and maximize the best of our service to every individual. It is our strategy to encourage our customers and for them to patronize the service.
  • 81.
    P a ge | 81 As the data shown in figure 13, 71.25% of the total sample population said that they are mostly willing to travel from Manila to Northern Luzon and vice versa using Manila – Dagupan Line. Service Strategy Trains allow passengers to travel in safety and comfort. It’s accessible to all and transports a large number of people at a time. Usually, train is quicker than traveling by road because there is no traffic. Trains are well - ventilated with air conditioners to ensure comfort while traveling. Passengers can do other things while they are traveling - talk on the phone, read, talk to others. Overall, GRT Company will provide quality and safety travel services. Customers will consider this service because of its superiority to offer travel service that will satisfy their needs. 71.25% 27.50% 1.25% Mostly Sometimes Never Figure 13 Willingness of passengers to Travel by train
  • 82.
    P a ge | 82 Pricing Strategy Price is one of the most important factors that effects on the buying decision of passengers. The table below shows the price of ticket. Stations 2015 2016 2017 2018 2019 Tutuban to Bocaue 180 180 180 180 180 Tutuban to Malolos Tutuban to San Fernando 230 230 230 230 230 Tutuban to Angeles Tutuban to Capas 280 280 280 280 280 Tutuban to Tarlac 330 330 330 330 330 Tutuban to Bayambang 380 380 380 380 380 Tutuban to Dagupan 430 430 430 430 430 Table 10 Projected GRT Ticket Price for Five Years
  • 83.
    P a ge | 83 Figure 14 Willingness to spend from Manila to first 4 stations Figure 15 Willingness to spend from Manila to 5 - 8 stations
  • 84.
    P a ge | 84 Figure 16 Willingness to spend from Manila to 9 - 12 stations Figure 17 Willingness to spend from Manila to 13 - 16 stations Figure 18 Willingness to spend from Manila to 17 to 20 stations
  • 85.
    P a ge | 85 Figure 19 Willingness to spend from Manila to 21 - 24 stations Figure 20 Willingness to spend from Manila to 25 -28 stations Figures above shows the result of market research conducted to know the market’s willingness to spend for our service. Sales Strategy GRT Company sales strategy emphases on generating profits and meeting increased market share position to where we initially established our business.
  • 86.
    P a ge | 86 Our sales strategy will be the opportunity to travel to provinces in without traffic. Through this strategy, passengers will be encouraged to try our service. Advertising and Promotion Strategy Advertising and promotional communication are an important part of brand marketing strategy. They are also a significant part of the cultural experience of millions of consumers. GRT Company advertising strategy will be using government television network. Marketing and Sales The sales of GRT Company are based on the survey result of acceptable sample size representing the primary target market. 2015 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 3,615,480 20.78% 751,432 - - - - Bocaue 3,615,480 5.69% 205,680 180.00 37,022,407.59 3,966,686.53 33,055,721.07 Malolos 3,615,480 10.48% 378,812 180.00 68,186,157.22 7,305,659.70 60,880,497.52 TOTAL 105,208,564.82 11,272,346.23 93,936,218.59 2016 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 3,615,480 20.78% 826,574.93 - - - - Bocaue 3,615,480 5.69% 226,248.05 180.00 40,724,648.35 4,363,355.18 36,361,293.17 Malolos 3,615,480 10.48% 416,693.18 180.00 75,004,772.94 8,036,225.67 66,968,547.27 San Fernando 3,615,480 9.44% 73,148 230.00 16,824,040.00 1,802,575.71 15,021,464.29 Angeles 3,615,480 14.70% 109,419 230.00 25,166,370.00 2,696,396.79 22,469,973.21 Capas 3,615,480 10.86% 127,467 280.00 35,690,760.00 3,824,010.00 31,866,750.00 TOTAL 193,410,591.30 20,722,563.35 172,688,027.94
  • 87.
    P a ge | 87 2017 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,067,415 20.78% 834,840.68 - - - - Bocaue 4,067,415 5.69% 228,510.53 180.00 41,131,894.84 4,406,988.73 36,724,906.11 Malolos 4,067,415 10.48% 420,860.11 180.00 75,754,820.67 8,116,587.93 67,638,232.74 San Fernando 4,067,415 9.44% 73,879.48 230.00 16,992,280.40 1,820,601.47 15,171,678.93 Angeles 4,067,415 14.70% 110,513.19 230.00 25,418,033.70 2,723,360.75 22,694,672.95 Capas 4,067,415 10.86% 128,741.67 280.00 36,047,667.60 3,862,250.10 32,185,417.50 tarlac 4,067,415 11.03% 448,737 330.00 148,083,171.61 15,866,054.10 132,217,117.51 Bayambang 4,067,415 6.07% 246,803 380.00 93,785,307.45 10,048,425.80 83,736,881.65 Dagupan 4,067,415 10.95% 445,388 430.00 191,516,646.54 20,519,640.70 170,997,005.84 TOTAL 628,729,822.81 67,363,909.59 561,365,913.22 2018 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,293,383 20.78% 843,189.08 - - - - Bocaue 4,293,383 5.69% 230,795.63 180.00 41,543,213.79 4,451,058.62 37,092,155.17 Malolos 4,293,383 10.48% 425,068.72 180.00 76,512,368.88 8,197,753.81 68,314,615.07 San Fernando 4,293,383 9.44% 74,618.27 230.00 17,162,203.20 1,838,807.49 15,323,395.72 Angeles 4,293,383 14.70% 111,618.32 230.00 25,672,214.04 2,750,594.36 22,921,619.68 Capas 4,293,383 10.86% 130,029.09 280.00 36,408,144.28 3,900,872.60 32,507,271.68 tarlac 4,293,383 11.03% 453,224.25 330.00 149,564,003.33 16,024,714.64 133,539,288.68 Bayambang 4,293,383 6.07% 249,271.48 380.00 94,723,160.52 10,148,910.06 84,574,250.47 Dagupan 4,293,383 10.95% 449,841.43 430.00 193,431,813.01 20,724,837.11 172,706,975.90 TOTAL 635,017,121.04 68,037,548.68 566,979,572.35
  • 88.
    P a ge | 88 2019 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,519,350 20.78% 851,620.97 - - - - Bocaue 4,519,350 5.69% 233,103.59 180.00 41,958,645.92 4,495,569.21 37,463,076.72 Malolos 4,519,350 10.48% 429,319.40 180.00 77,277,492.57 8,279,731.35 68,997,761.22 San Fernando 4,519,350 9.44% 75,364.46 230.00 17,333,825.24 1,857,195.56 15,476,629.68 Angeles 4,519,350 14.70% 112,734.51 230.00 25,928,936.18 2,778,100.30 23,150,835.87 Capas 4,519,350 10.86% 131,329.38 280.00 36,772,225.72 3,939,881.33 32,832,344.39 tarlac 4,519,350 11.03% 457,756.50 330.00 151,059,643.36 16,184,961.79 134,874,681.57 Bayambang 4,519,350 6.07% 251,764.19 380.00 95,670,392.13 10,250,399.16 85,419,992.97 Dagupan 4,519,350 10.95% 454,339.84 430.00 195,366,131.14 20,932,085.48 174,434,045.66 TOTAL 641,367,292.25 68,717,924.17 572,649,368.08 Table 11 Computed Sales For the Year 2015 Year Sale – VAT Inclusive Sale – Vat Exclusive 2015 105,208,564.82 93,936,218.59 2016 193,410,591.30 172,688,027.94 2017 628,729,822.81 561,365,913.22 2018 635,017,121.04 566,979,572.35 2019 641,367,292.25 572,649,368.08 Table 12 Computed Sales for five years operation
  • 89.
    P a ge | 89 Figure 21 Sales for the years 2015 - 2019
  • 90.
    P a ge | 90 TECHNICAL ASPECT
  • 91.
    P a ge | 91 Technical Aspect In this section shows the basic and operation flow of the business. Also the technical principles and practices in the implementation of the project. Technical aspect covers the materials, equipment, lay-out of the service, supplies of materials, structure plan, location and expenses. Technical aspect is one of the most important parts of the study because it covers the technicality of the service in your business. It also covers the availability of all the materials and properties of the business and it also requires that the location of the business is near to the location of the operations and also to the customer. Service Description Railway transport is a kind of transportation that can carry people and goods that the wheels are connected to the rails. It also called as train transport. Unlike vehicles running on land, rail road vehicles are running directionally lead on the pathways that are connected to the surface. Basically the tracks are steel rails that are installed in the railroad tie and track ballast, on which the rolling stock with an installed metal wheels moves. Railroad transportation is one of the most convenient modes of transportation today. Aside from being fast and cheap, it will cause you less time to go from one place to another because there is no traffic ahead. Most of the people that are going to work use this kind of transportation. One of major concerns of passengers going to Northern provinces is high fare because of the toll fees. Most people can’t afford to go to provinces especially the low – income class family.
  • 92.
    P a ge | 92 GRT Company is planning on reviving the railroad from Tutuban to Dagupan in order to help the passengers to go to these provinces in a fast way with cheaper price. The company aims to make the railroad more suitable to passengers especially to the low - income class family and also to allow traveling of goods coming from these provinces. Location Figure 22 GRT Company Office Location
  • 93.
    P a ge | 93 Figure 23 Satellite View Map Figure 24 Actual Site
  • 94.
    P a ge | 94 The site is located at 3F Natividad Building T.M. Kalaw Street Ermita, Manila with a measurement of 150 sqm. This business will be targeting the Manila - Dagupan Railway that was closed since 1939. This area will include offices, conference rooms, pantry, comfort rooms, lobby, elevators and parking space. Route Map Figure 25 Route Map Tutuban to Dagupan
  • 95.
    P a ge | 95 On figure, this will be the route map of the railway from Tutuban (Manila) to Dagupan (Pangasinan). It has a total distance of 214 km and has a travel time of 1 hour and 46 mins. Building and Facilities There will be stations in Tutuban in Manila, Bocaue and Malolos in Bulacan, San Fernando and Angeles in Pampanga, Capas and Tarlac City in Tarlac, and Bayambang to Dagupan in Pangasinan. Each stations consist of a manual type of ticket system and an automatic type of ticket system. It also have a ticketing system for PWD (Persons with Disability). GRT Company Office is located just 2.5 kilometers from the Tutuban station to easily monitor the line. All the stations of Manila – Dagupan Line will have the same appearance of building to easily recognize by the people. Tutuban Station
  • 96.
    P a ge | 96 Malolos Station Bocaue Station
  • 97.
    P a ge | 97 San Fernando Station Angeles Station
  • 98.
    P a ge | 98 Capas Station Tarlac City Station
  • 99.
    P a ge | 99 Bayambang Station Dagupan Station
  • 100.
    P a ge | 100 Figure 26 GRT Office Layout
  • 101.
    P a ge | 101 Figure 27 Electrical Layout
  • 102.
    P a ge | 102 Figure 28 Station Layout
  • 103.
    P a ge | 103 Time Travel Tutuban Bocaue Malolos San Fernando Angeles Capas TarclacCity Bayambang Dagupan Tutuban 0 km 0.22 0.52 0.84 0.95 1.15 1.27 1.67 1.95 Bocaue 26.1 km 0.22 0.14 0.62 0.73 0.94 1.05 1.45 1.74 Malolos 42.5 km 0.52 0.14 0.32 0.59 0.80 0.91 1.32 1.43 San Fernando 80.3 km 0.84 0.62 0.32 0.10 0.49 0.60 1 1.28 Angeles 92.8 km 0.95 0.73 0.59 0.10 0.21 0.49 0.90 1.18 Capas 118.2 km 1.15 0.94 0.80 0.49 0.21 0.11 0.68 0.97 Tarlac City 131.5 km 1.27 1.05 0.91 0.60 0.49 0.11 0.40 0.86 Bayambang 179.9 km 1.67 1.45 1.32 1 0.90 0.68 0.40 0.28 Dagupan 214 km 1.95 1.74 1.43 1.28 1.18 0.97 0.86 0.28 Table 13 Station's Distance from Tutuban Table 14 Travel Time in hours with a speed of 120 km/hr. and an interval of 10 minutes per station. Stations Code Distance Tutuban TU 0 km Bocaue BO 26.1 km Malolos MAL 42.5 km San Fernando SF 80.3 km Angeles AN 92.8 km Capas CP 118.2 km Tarlac City TC 131.5 km Bayambang BY 179.9 km Dagupan DG 214 km
  • 104.
    P a ge | 104 Station Time Tutuban 5:00am, 7:00am, 9:00am, 11:00am, 1:00pm, 3:00pm, 5:00pm, 7:00m, 9:00pm Bocaue 5:14am, 7:14am, 9:14am, 11:14am, 1:14pm, 3:14pm, 5:14pm, 7:14pm, 9:14pm Malolos 5:32am, 7:32am, 9:32am, 11:32am, 1:32pm, 3:32pm, 5:32pm, 7:32pm, 9:32pm San Fernando 5:51am, 7:51am, 9:51am, 11:51am, 1:51pm, 3:51pm, 5:51pm, 7:51pm, 9:51pm Angeles 5:57am, 7:57am, 9:57am, 11:57am, 1:57pm, 3:57pm, 5:57pm, 7:57pm, 9:57pm Capas 6:09am, 8:09am, 10:09am, 12:09pm, 2:09pm, 4:09pm, 6:09pm, 8:09pm, 10:09pm Tarlac City 6:17am, 8:17am, 10:17am, 12:17pm, 2:17pm, 4:17pm, 6:17pm, 8:17pm, 10:17pm Bayambang 6:41am, 8:41am, 10:41am, 12:41pm, 2:41pm, 4:41pm, 6:41pm, 8:41pm, 10:41pm Dagupan 6:57am, 8:57am, 10:57am, 12:57pm, 2:57pm, 4:57pm, 6:57pm, 8:57pm, 10:57pm Table 15 Train Schedules from Tutuban
  • 105.
    P a ge | 105 Station Time Dagupan 5:00am, 7:00am, 9:00am, 11:00am, 1:00pm, 3:00pm, 5:00pm, 7:00m, 9:00pm Bayambang 5:17am, 7:17am, 9:17am, 11:17am, 1:17pm, 3:17pm, 5:17pm, 7:17pm, 9:17pm Tarlac City 5:52am, 7:52am, 9:52am, 11:52am, 1:52pm, 3:52pm, 5:52pm, 7:52pm, 9:52pm Capas 5:59am, 7:59am, 9:59am, 11:59am, 1:59pm, 3:59pm, 5:59pm, 7:59pm, 9:59pm Angeles 6:11am, 8:11am, 10:11am, 12:11pm, 2:11pm, 4:11pm, 6:11pm, 8:11pm, 10:11pm San Fernando 6:14am, 8:14am, 10:14am, 12:14pm, 2:14pm, 4:14pm, 6:14pm, 8:14pm, 10:14pm Malolos 6:26am, 8:26am, 10:26am, 12:26pm, 2:26pm, 4:26pm, 6:26pm, 8:26pm, 10:26pm Bocaue 6:45am, 8:45am, 10:45am, 12:45pm, 2:45pm, 4:45pm, 6:45pm, 8:45pm, 10:45pm Tutuban 6:57am, 8:57am, 10:57am, 12:57pm, 2:57pm, 4:57pm, 6:57pm, 8:57pm, 10:57pm Table 16 Train Schedules From Dagupan
  • 106.
    P a ge | 106 Serving Process The diagram below shows the Magnetic Card Ticket that customers will be using is entering the premises in order to ride the train. This will be the key of entering and exiting in the train. Stored value will worth 300 pesos good for 6 months, and the Single Journey ticket will be good for only the day the customer buys it. Figure 30 Stored Value Template Figure 29 Single Journey Template
  • 107.
    P a ge | 107 Process Average Distance Average Time Remarks - - - 4 m 7 s - - 5 s Money 5 m 8 s - - 2 s Train Ticket 5 m 4 s - Total 14 meters 26 seconds Figure 31 Entering Station The passenger will enter the station The passenger will go to the ticket vendor The passenger will buy the ticket from the ticket vendor The passenger will go to the automatic card reader The passenger will enter the train The passenger will insert the ticket in the automatic card reader
  • 108.
    P a ge | 108 Process Average Distance Average Time Remarks - - - 5 m 5s - - 2s Train Ticket 9 m - Total 14 meters 7 Seconds Figure 32 Exit on station The passenger will exit the train The passenger will exit the station The passenger will insert the ticket in the automatic card reader The passenger will go to the automatic card reader
  • 109.
    P a ge | 109 Service Year 2015 2016 2017 2018 2019 Train 3,615,480 3,615,480 4,067,415 4,293,383 4,519,350 Total 3,615,480 3,615,480 4,067,415 4,293,383 4,519,350 Figure 33 Store Capacity Materials and Equipment Materials and equipment serves an important role in the business in order to be profitable and to be able to run in a long term. GRT Company believes that providing the best service can satisfy the customers during on the station
  • 110.
    P a ge | 110 Service Supplies (Direct Supplies) Item Unit Cost Quantity/Sup plier Total Cost Life span Depreciation Cost 1. Train 1 pc 153,750,875 9/ Japan Railway System 307,501,750 50 years 28,395,157.5 2. Railway 1 km 34,400,000 214/ Japan Railway System 7,361,600,000 50 years 147,232,000 3. Clock 1 pc 295 18/ Western Digital 5,310 5 years 1,062 4. Automatic Card Reader 1 pcs 150,000 72/ 10,800,000 15 years 720,000 5. Magnetic Card Ticket 1 pc 45.15 900,000/ Shen zhen Chuangxinjia RFID Tag Co., Ltd. 40,635,000
  • 111.
    P a ge | 111 6. CCTV Camera 1 Pack age 1,180 10/ CDR King 11,800 5 years 5 years TOTAL 8,756,205,665 175,636,715.50 Item Unit Unit Cost Quantity (Annual)/ Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 4,500 8/ Pc Gilmore Computer Center 36,000 5 years 7200.00 2. 3 in 1 Printer 1 Unit 2,000 2/ Pc Gilmore Computer Center 4,000 5 years 800.00 3. Aircon 1 Unit 12,000 3/ Pc Gilmore Computer Center 36,000 10 years 3,600 4. Fax Machine 1 Unit 5,800 1/villman 5,800 5 years 1160
  • 112.
    P a ge | 112 Item Unit Unit Cost Quantity (Annual)/ Supplier Total Cost Life Span Depreciation Cost 5.Water Dispenser 1 unit 4,798 1/ Abenson 4,798 5 years 959.6 6.Refrigerator 1 unit 7,695 1/ Lazada 7,695 10 years 769.50 7. CCTV Camera 1 Pack age 1,180 10/ CDR King 11,800 5 years 2360.00 8. Microwave Oven 1 unit 3,368 1/Abenson 3,368 5 years 673.6 Total 109,461.00 17,522.70 Figure 34 Office Equipment
  • 113.
    P a ge | 113 Item Unit Unit Cost Quantity (Annual)/ Supply Total cost 1. Black Ballpen 25.00 pcs/box 90.00 6/ Office 1 e-shop 540.00 2. Paper Clips 100 pcs/ box 13.75 1/ Office 1 e-shop 13.75 3. Bond paper (A4) 1 Rim 140.00 1/Office 1 e-shop 165.00 4. Record Book (300 leaves) 1 pc 41.25 4/Office 1 e-shop 165.00 5. Folder (Long) 1 2.50 10/Office 1 e-shop 25.00
  • 114.
    P a ge | 114 Item Unit Unit Cost Quantity (Annual)/ Supply Total cost 6. Marker 12 pcs/box 96.00 1/ Office 1 e-shop 96.00 7. Stapler 1 pc 45.00 2/ Office 1 e-shop 90.00 8. Staple wire 1 box 4.83 4/ Office 1 e-shop 19.32 9. Staple Remover 1 pc 12.00 2/ Office 1 e-shop 24.00
  • 115.
    P a ge | 115 Item Unit Unit Cost Quantity (Annual)/ Supply Total cost 10. Journal 4 books/ set 400.00 1/Office 1 e-shop 400.00 11. Ink for Printer 1 set 1,200.00 1/ Office 1 e-shop 1,200.00 12. Paper roll 1 roll 8.75 80/ Office 1 e-shop 700.00 Total 3413.07 Total 3413.07 Total Figure 35 Office Supplies
  • 116.
    P a ge | 116 Item Unit Unit Cost Quantity (Annual)/Supply Total Cost Life span Depreciation Cost 1. Office Desk 1 2,500 7/ ADB Office Furniture 17,50 0 5 years 3,500.00 2. Office Chair 1 650 7/ ADB Office Furniture 4,550 5 years 910.00 3. Filing Cabinet 1 4,300 1/ ADB Office Furniture 4,300 15 years 286.67 4. Monobloc 1 320.0 0 3/ ADB Office Furniture 640.0 0 10 years 64.00
  • 117.
    P a ge | 117 Item Unit Unit Cost Quantity (Annual)/Supply Total Cost Life span Depreciation Cost 5. Fire Extinguisher 1 7,800 3/ ADB Office Furniture 23,40 0 10 years 2,340.00 6. Storage Cabinet 1 1,999 6/ ADB Office Furniture 11,99 4 10 years 1,199.40 Total 62,384 8,300.07 Figure 36 Office Furniture
  • 118.
    P a ge | 118 Item Unit Unit Cost Quantity (Annual)/Supplier Total Cost Life Span Depreciati on Cost 1. Computer Set 1 set 4,500 27/ Pc Gilmore Computer Center 121,500 5 years 24,300 2. 3-in-1 Printer 1 unit 2,000 9/ Pc Gilmore Computer Center 18,000 5 years 3,600 3. Fax Machine 1 unit 5,800 9/ Villman 52,200 5 years 10,440 4. CCTV Camera 1 packa ge 1,180 18/ Pc Gilmore Computer Center 21,240 5 years 4,248 5. Aircon 1 unit 12,00 0 9/ Pc Gilmore Computer Center 108,000 10 years 10,800 6. Magnetic Car Dispenser 1 unit 28000 9 252000 5 50,400 TOTAL 572,940 53,399 Figure 37 Station Equipment
  • 119.
    P a ge | 119 Items Unit Unit Cost Quantity(Annual)/Sup plier Total Cost 1. Black Ballpen 25 pcs/box 90 54/ Office 1 e-shop 4,860 2. Paper Clips 100pcs/box 13.75 9/ Office 1 e-shop 123.75 3. Bond paper (A4) 1 rim 140 9/ Office 1 e-shop 1260 4. Record Book (300 leaves) 1pc 41.25 36/ Office 1 e-shop 1485 5. Folder (Long) 1 2.5 90/ Office 1 e-shop 225 6. Marker 12pcs/box 96 9 864
  • 120.
    P a ge | 120 7. Stapler 1 pc 45 18/ Office 1 e-shop 810 8. Staple wire 1 box 4.83 36/ Office 1 e-shop 173.88 9. Staple Remover 1 pc 12 18/ Office 1 e-shop 2,16 10. Journal 4 books/set 400 9/ Office 1 e-shop 3,600 11. Ink for Printer 1 set 1200 9/ Office 1 e-shop 10,800 12. Paper roll 1 roll 8.75 720 6,300 TOTAL 30717.63 Figure 38 Station Supplies
  • 121.
    P a ge | 121 Items Unit Unit Cost Quantity/Suppli er Total Cost Life span Depreciation Cost 1. Office Desk 1 2500 9/ ADB Office Furniture 22500 5 years 4,500 2. Office Chair 1 650 9/ ADB Office Furniture 5850 5 yeas 1,170 3. Filing Cabinet 1 4300 9/ ADB Office Furniture 38700 15 years 2,580 4. Monobloc 1 320 27/ ADB Office Furniture 8640 10 years 864
  • 122.
    P a ge | 122 Items Unit Unit Cost Quantity Total Cost Life span Depreciation Cost 5. Fire Extinguisher 1 7800 27/ ADB Office Furniture 210600 10 years 21,060 6. Storage Cabinet 1 19900 9/ ADB Office Furniture 179100 10 years 17,910 7. Table 1 1750 9/ ADB Office Furniture 15750 10 years 1,575 TOTAL 481140 49,659 Figure 39 Stations Furniture
  • 123.
    P a ge | 123 Item Unit Cost Quantity/ Supplier Total Cost Life span Deprecia tion Cost 1. Urinal 1 pcs 2,895 18/ ACE Hardware 52,100 20 years 2,605.5 2. Toilet bowl w/ Spray 1 pcs 3,050 36/ ACE Hardware 109,800 20 years 5,490 Total 161,900 8,095.5 Figure 40 Toilet Fixtures (Station)
  • 124.
    P a ge | 124 Items Unit Cost/ Unit Quantity Total Cost 1. Air Freshener 1 piece 140 36 5,040 2. Broom 1 piece 120 18 2,160 3. Stick broom 1 piece 10 9 90 4. Dust pan 1 piece 80 18 1,440 5. Floor Mop 1 piece 180 9 1,620
  • 125.
    P a ge | 125 Items Unit Cost/ Unit Quantity Total Cost 6. Garbage Bags 1 roll 10 225 2,250 7. Garbage Cans 1 piece 100 18 1,800 8. Liquid Soap (Exel) 1 bottle 60 90 5,400 9. Hand Wash 1 bottle 35 36 1,260 10. Toilet Paper 1 roll 10 450 4,500 TOTAL 25,560 Figure 41 Janitorial and Comfort Room Supplies and Expenses
  • 126.
    P a ge | 126 Utilities Expense Water Water is one of the most important materials in business. In our office, water is used to wash hands, wash the dishes, clean waste, etc. GRT Corporation will acquire the supply of water from Maynilad Water Company Incorporated. WATER EXPENSE Consumption 100 cu.m PHP Basic Charge 5,297.40 FCDA (-0.00) Environmental Charge 1059.48 Sewer Charge 1589.22 MSC 30.00 12% VAT 957.132 Total Monthly Bill 267,996.96 Power/Light For the business to be operated effectively, electricity is the most important factor. It’s also important in the stations so that it will power up all the ticket machines. When using telephone and internet, cables are needed in order to make communication from the office to the stations and also with the help of the WWW (World Wide Web). GRT Company will get supply the electricity from Manila Electric Company (MERALCO). Table 17 Office and Stations Water Expense
  • 127.
    P a ge | 127 Power/Light (Office) Lighting Equipment Consumption Equipment Quantity Hours of Usage Wattage kWh Price Fluorescent light 11 8 40 3.52 30.67 Pin lights 3 8 40 0.96 8.36 Service Equipment Consumption Equipment Quantity Hours of Usage Wattage kWh Price Exhaust fan 1 6 35 0.21 1.83 Printer 9 4 100 3.6 31.37 ACU 3 8 1120 26.88 234.20 CCTV 10 24 300 72 627.33 Desktop Computer 8 8 543 34.752 302.79 Refrigerator 1 8 90 0.72 6.27 Water Dispenser 1 8 25 0.2 1.74 Microwave oven 1 1 900 0.9 7.84 Fax Machine 1 1 100 0.1 0.87 Total daily consumption 141.92 1,236.55 Total monthly consumption 4,257.66 37,096.57 Breakdown of Electricity Charges Bill subgroup Percentage Subtotal Generation 0.6468 23994.06 Transmission 0.1109 4114.01 System Loss 0.0664 2463.21 Distribution 0.3198 11863.48 Subsidies (Commercial) -0.5703 -21156.17 Government Taxes 0.0596 2210.96 Universal Charges 0.0405 1502.41 Other Charges 0.3264 12108.32 Figure 42 Office Electricity Expense
  • 128.
    P a ge | 128 Power/Light (Stations) Lighting Equipment Consumption Equipment Quantity Hours of Usage Wattage kWh Price Fluorescent light 72 16 40 46.08 401.49 Pinlights 27 16 40 17.28 150.56 Service Equipment Consumption Equipment Quantity Hours of Usage Wattage kWh Price Exhaust fan 36 8 35 10.08 87.83 Printer 9 8 100 7.2 62.73 ACU 18 16 1120 322.56 2810.43 CCTV 36 24 300 259.2 2258.38 Desktop Computer 27 16 784 338.688 2950.95 Total daily consumption 1,001.09 8,722.38 Total monthly consumption 30,032.64 261,671.39 Telephone and Internet Expenses Philippine Long Distance Telephone Company (PLDT) will be the one who will be installing the telephones in GRT and in the stations. To ensure that all stations in Manila – Dagupan railway will have a good communication. TELEPHONE AND INTERNET EXPENSE PHP Installation Fee Free Landline Plan 7,000 Plan 2899 (Internet) 88,000 12% VAT (Internet) 10,560 Total Monthly Bill 10,5560 Table 18 Office and Stations Telephone and Internet Expenses Item Quantity Unit Cost Total Cost Train Driver 27 500 13,500 Figure 44 Uniform Expenses Figure 43 Stations Electricity Expenses
  • 129.
    P a ge | 129 Figure 45 Uniform Design Rent Expense (Office) Gicha Ressha Train will be renting a 90 sqm office space located at Natividad Building T.M. Kalaw Street, Ermita Manila. Cost Rent Cost (512 per sqm) 46,170 Renovation 192,000 Total 238,170
  • 130.
    P a ge | 130 Gas Expense Gas expense will be use to make the train (Kogane) work. 2014 Liter Price per Liter Total 379 44.16 16,736.64 33473.28 Total per month 401,679.4 ANNUAL GAS EXPENSE 2015 2016 2017 2018 2019 2020 409,712.9 417,907.2 426,265.4 434,790.7 443,486.5 452,356.2 *Note: 379L is good for 15 days
  • 131.
    P a ge | 131 Land Expense Location Total Land Area (sqm) Price per sqm (Php) Price (Php) Tutuban 2753 2,654 7,306,462 Bocaue 1576 2,589 4,080,264 Malolos 2536 3,532 8,957,152 Capas 2021 2,587 5,228,327 Tarlac 2092 2,896 6,058,432 San Dernando 1214 2,764 3,355,496 Angeles 2990 2,365 7,071,350 Bayambang 2261 3,032 6,855,352 Dagupan 2492 3,582 8,926,344 Total 57,839,179 Building Cost Per Station Cost Construction Permit Cost 4,796,272.4 Net Construction Cost 15,277,352 Total Electrical Material Cost 807,690 Total Plumbing Material Cost 1,200,000+ Total Building Cost Per Station PHP 22,144,314.4 Total Building Cost PHP 199,298,830 Permits and Licenses Cost Securities and Exchange Commission 10,999.26 Department of Trade and Industry 4,500.00 Bureau of Internal Revenue 4,770.00 Business Permit Business tax 112,500.00 Mayor’s Permit 1,800.00 Sanitary Inspection Fee 3,600.00 Garbage fee 11,700.00 Zoning Clearance 4,905.00 Signage fee 450.00 Business Plate 4,500.00 Barangay Clearance 4,500.00 Total 164,224.26
  • 132.
    P a ge | 132 Waste Disposal Method All stations from Manila to Dagupan are responsible to the health of people and the same time the condition of the environment to their respective locations. GRT will provide trash bin in every stations to secure that we maintain the good atmosphere and at the same time we will assure you that we place it at the right place. Before opening the station to passengers, garbage will be collected the day before by the respective garbage collector. We also prepare a segregation scheme in order to separate the biodegradable and non-biodegradable trash. Re-using of scratch paper that can help reduce supplies cost of the company as well as helping save trees.
  • 133.
    P a ge | 133 Technical Assumptions  The proponents assume that there is 2% increase in Office Supplies expense every year.  The proponents assume that there is 2% increase in Rental Expense every year.  The proponents assume that there is 5% increase in Water Expense every year.  The proponents assume that there is 5% increase in Power/Light Expense every year.  The proponents assume that there is 2% increase in Permits and Licenses every year.  The proponents assume that there is 2% increase in Gas Expense every year.
  • 134.
    P a ge | 134 FINANCIAL ASPECT
  • 135.
    P a ge | 135 CAPITAL Pre-Operating Expenses Permits and Licenses P 164,224 Service Equipments 8,792,163,185 Station Equipments 572,940 Office Equipments 106,093 Station Furnitures and Fixtures 481,140 Office Furniture and Fixtures 224,614 Supplies 18,168 Building 199,298,830 Land 57,839,179 Uniform 13,500 Salaries 1,374,461 Cash on Hand 7,743,666 TOTAL PROJECT COST P 9,060,000,000 Partner's Contribution 3,020,000,000.00 Table 19 Project Cost
  • 136.
    P a ge | 136 Gicha Ressha Train Company Income Statement For the Years Ended 2015 - 2019 2015 2016 2017 2018 2019 Service Revenue 105,208,565 193,410,591 628,729,823 635,017,121 641,367,292 Operating Expenses Salaries and Wages 6,116,880 13,065,600 12,849,600 18,638,400 18,422,400 SSS Contribution 216,372 461,309 664,061 664,061 664,061 PhilHealth Contribution 67,380 151,800 217,050 217,050 217,050 Pag-IBIG Contribution 67,380 127,680 174,480 174,480 174,480 13th month pay 606,400 1,070,800 1,535,200 1,535,200 1,535,200 Uniform Expense 13,500 - - - - Power/Light Expense 734,799 2,297,103 2,343,046 2,389,906 2,437,705 Telephone w/ Internet expense 221,676 1,292,054 1,317,895 1,344,253 1,371,138 Water Expense 446,645 2,603,301 2,655,367 2,708,474 2,762,644 Supplies expense 58,206 59,370 60,557 61,768 63,004 Rent Expense 230,850 923,400 923,400 923,400 923,400 Professional Fee 12,000 12,000 12,000 12,000 12,000 Permits and Licenses 51,724 52,759 53,814 54,890 55,988 Gas Expense 2,458,278 2,507,443 2,557,592 2,608,744 2,660,919 Supplies Expense 58,206 59,370 60,557 61,768 63,004 Depreciation Expense 162,474,828 162,474,828 162,474,828 162,474,828 162,474,828 Total Operating Expense 173,835,123 187,158,817 187,899,447 193,869,224 193,837,820 Income Before Income Tax (68,626,558) 6,251,774 440,830,376 441,147,897 447,529,472 Basic Corporate Income Tax (30% of Net Profit) 0 0 113,536,677 132,344,369 134,258,842 Minimum orporte Income Tax (2% of Gross Profit) N/A N/A N/A N/A 12,827,346 Income Tax Expense (higher between BCIT and MCIT) 0 0 113,536,677.42 132,344,369 134,258,842 Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631 Table 20 Income Statement
  • 137.
    P a ge | 137 Gicha Ressha Train Company Statement of Changes in Equity For the Years Ended 2015 - 2019 2015 2016 2017 2018 2019 Bacoy, Christian O. 3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544 Withdrawals - (400,000) (400,000) (400,000) (400,000) Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 Balisi, Danica C. 3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544 Withdrawals - (400,000) (400,000) (400,000) (400,000) Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 Rubico, Jonathan Ray DL. 3,020,000,000 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 Net Income (22,875,519) 2,083,925 109,097,899 102,934,509 104,423,544 Withdrawals - (400,000) (400,000) (400,000) (400,000) Capital Ending 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 Total Owner's Equity 8,991,373,442 8,996,425,216 9,322,518,914 9,630,122,442 9,942,193,073 Table 21 Statement of Changes in Owner's Equity
  • 138.
    P a ge | 138 Gicha Ressha Train Company Statement of Cash Flows For the Years Ended 2015 - 2019 2015 2016 2017 2018 2019 Cash Flows from Operating Activities Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631 Depreciation Expense 162,474,828 162,474,828 162,474,828 162,474,828 162,474,828 Increase (Decrease) in Gas 13,674,405 14,209,173 273,296,534 (75,104,137) (127,194,490) Increase (Decrease) in Income Tax Payable - - (113,536,677) (18,807,692) (1,914,473) Increase (Decrease) in Salaries Payable (510,237) (1,414,661) (394,187) - - Increase (Decrease) in SSS Payable (21,546) (16,896) (16,896) - - Increase (Decrease) in PAG-iBIG Payable (6,740) (3,900) (3,900) - - Increase (Decrease) in Philhealth Payable (7,213) (5,438) (5,438) - - Increase (Decrease) in Withholding Tax Payable - Salaries (616,010) 511,367 (43,980) - - Increase (Decrease) in Power/Lighting Payable (149,515) (1,562,304) (45,942) (46,861) (47,798) Increase (Decrease) in Water Payable (446,645) (2,156,656) (52,066) (53,107) (54,169) Increase (Decrease) in Rent Payable (230,850) (692,550) - - - Increase (Decrease) in Telephone w/ Internet (221,676) (1,070,378) (25,841) (53,107) (26,885) Income Tax Paid - - - 113,536,677 132,344,369 Net Cash from Operating Activities 105,312,243 176,524,358 648,940,134 490,750,128 478,852,013 Cash Flows from Investing Activities Building 199,298,830 - - - - Land 57,839,179 Renovation 150,000
  • 139.
    P a ge | 139 Office Equipment 106,093 - - - - Office Furniture and Fixtures 224,614 - - - - Station Equipments 481,140 - - - - Service Equipment 8,792,163,185 - - - - Station Furnitures and Fixtures 481,140 - - - - Supplies 58,206 1,164 1,187 1,211 1,235 Net Cash from Investing Activities (9,050,802,386) (1,164) (1,187) (1,211) (1,235) Cash Flows from Financing Activities Owner's Investment - - - - - Withdrawals - (1,200,000) (1,200,000) (1,200,000) (1,200,000) Net Cash from Financing Activities - (1,200,000) (1,200,000) (1,200,000) (1,200,000) Net Cash Increase (Decrease) (8,945,490,144) 175,323,194 647,738,946 489,548,917 477,650,777 Cash Beginning 9,060,000,000 114,509,856 289,833,050 937,571,996 1,427,120,913 Cash Ending 114,509,856 289,833,050 937,571,996 1,427,120,913 1,904,771,691 Table 22 Statement of Cash Flow
  • 140.
    P a ge | 140 Gicha Ressha Train Company Statement of Financial Position For the Years Ended 2015 - 2019 2015 2016 2017 2018 2019 ASSETS Cash 114,509,856 289,833,050 937,571,996 1,427,120,913 1,904,771,691 Gas 1,519,378 3,098,175 4,586,499 4,613,795 4,120,062 Land 57,839,179 57,839,179 57,839,179 57,839,179 57,839,179 Building 199,298,830 199,298,830 199,298,830 199,298,830 199,298,830 Renovation,net 150,000 144,000 138,000 132,000 126,000 Station Equipments 572,940 572,940 572,940 572,940 572,940 Office Equipment 106,093 106,093 106,093 106,093 106,093 Station Furniture and Fixtures 481,140 481,140 481,140 481,140 481,140 Office Furniture and Fixtures 224,614 224,614 224,614 224,614 224,614 Service Equipment 8,792,163,185 8,792,163,185 8,792,163,185 8,792,163,185 8,792,163,185 Accumulated Depreciation-all (162,474,828) (324,949,655.57) (487,424,483.35) (649,899,311.13) (812,374,138.91) TOTAL ASSETS 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594 LIABILITIES Power/Lighting Payable 187,655 191,408 195,236 199,141 203,124 Water Payable 212,688 216,942 221,281 225,706 230,220 Rent Payable 76,950 76,950 76,950 76,950 76,950 Telephone w/ Internet Payable 105,560 107,671 109,825 112,021 114,262 Salaries Payable 510,237 904,424 1,298,611 1,298,611 1,298,611 SSS Payable 21,546 38,442 55,338 55,338 55,338
  • 141.
    P a ge | 141 Phil Health payable 7,213 12,650 18,088 18,088 18,088 Pag-IBIG Payable 6,740 10,640 14,540 14,540 14,540 Income Tax Payable - - 113,536,677 132,344,369 134,258,842 Withholding Tax Payable - Salaries 616,010 104,643 148,623 148,623 148,623 VAT Payable 11,272,346 20,722,563 67,363,910 68,037,549 68,717,924 TOTAL LIABILITIES 13,016,946 22,386,334 183,039,079 202,530,936 205,136,522 OWNER'S EQUITY BACOY, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 BALISI, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 RUBICO, Capital 2,997,124,481 2,998,808,405 3,107,506,305 3,210,040,814 3,314,064,358 TOTAL OWNER's EQUITY 8,991,373,442 8,996,425,216 9,322,518,914 9,630,122,442 9,942,193,073 TOTAL LIABILITIES AND OWNER'S EQUITY 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594 Table 23 Statement of Financial Position
  • 142.
    P a ge | 142 Financial Analysis The process of evaluating businesses, projects, budgets and other finance- related entities to determine their suitability for investment. Typically, financial analysis is used to analyze whether an entity is stable, solvent, liquid, or profitable enough to be invested in. A. Liquidity Ratio 2015 2016 2017 2018 2019 Current Assets 116,029,235 292,931,225 942,158,495 1,431,734,709 1,908,891,753 Current Liabilities 1,744,599 1,663,771 115,675,169 134,493,388 136,418,597 Liquidity Ratio 67 176 8 11 14 Table 24 Current Ratio Table determines the company's ability to pay off its short-terms debts obligations. B. Profitability Ratio 2015 2016 2017 2018 2019 Sales 105,208,565 193,410,591 628,729,823 635,017,121 641,367,292 Service revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373 Gross Profit Margin 97.7% 98.7% 99.6% 99.6% 99.6% Table 25 Gross Profit Margin Table shows the company’s’ financial health by revealing the proportion of money left over from revenues after accounting for the cost of goods sold. 2015 2016 2017 2018 2019 Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631 Service revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373 Net profit Margin -67% 3% 52% 49% 49% Table 26 Net Profit Margin A ratio of profitability calculated as net income divided by revenues, or net profits divided by sales. It measures how much out of every sale a company actually keeps in earnings.
  • 143.
    P a ge | 143 2015 2016 2017 2018 2019 Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631 Total Assets 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594 Return of Assets -1% 0.1% 3.44% 3.14% 3.09% Table 27 Return on Assets Table shows how profitable a company is relative to its total assets. ROA gives an idea as to how efficient management is at using its assets to generate earnings. 2015 2016 2017 2018 2019 Net Income (68,626,558) 6,251,774 327,293,698 308,803,528 313,270,631 Shareholder’s Equity 9,060,000,000 9,060,000,000 9,060,000,000 9,060,000,000 9,060,000,000 Return on Equity -0.7575% 0.0690% 3.6125% 3.4084% 3.4577% Table 28 Return on Equity Table shows the return on equity which measures a company's profitability by revealing how much profit a company generates with the money shareholders have invested. C. Activity Ratio 2015 2016 2017 2018 2019 Service Revenue 102,750,287 190,903,148 626,172,231 632,408,377 638,706,373 Total Assets 9,004,390,387 9,018,811,550 9,505,557,993 9,832,653,378 10,147,329,594 Total Asset Turnover 0.011 0.021 0.066 0.064 0.063 Table 29 Total Asset Turnover Table shows the turnover asset ratio which is an indicator of the efficiency with which a company is deploying its assets. Payback period Investment 9,060,000,000 Average Net Income 316,455,952.30 Payback period 28.63 years Table 30 Payback Period This refers to the length of period or number of years it would take to recover an investment. The business would take three years and 26 days to recover the investment.
  • 144.
    P a ge | 144 SOCIO – ECONOMIC ASPECT
  • 145.
    P a ge | 145 SOCIO – ECONOMIC ASPECT Railways are the main artery of inland transport in an economy. They are an energy- efficient mode of transportation, ideally suitable for large scale movement of manpower, bulk commodities and for long distance travel. They are the lifeline of the country and hold great importance in its socio-economic development. A well-established railway system brings together people from the farthest corners of the country and makes possible the conduct of business, sightseeing, pilgrimage and education. It improves the quality of life and thus helps to accelerate the growth of industry and agriculture. We will not operate just to gain profit but to help the government and the society through the following aspect: a. Gicha Ressha Train Company assures to provide high quality services for the country to have a strong railway transit. b. GRT Company is committed to being responsible and attractive employers. c. To be able to maintain high levels of safety and security by comprehensive management. d. Apply precautionary approaches to environmental challenges and support initiatives, projects and new technologies for further improved environmental performance. Contribution to Society GRT Company will be the backbone for sustainable mobility and transport systems in our society. Rail offers solutions to cope with the mobility and transport challenges of the future. Rail has lower impact on climate and environment than most other transport modes. It is the safest mode of transport and relieves roads and reduces congestion. Our service has macro- economic advantages for society and enhances sustainable integration of transport and mobility modes. Customer Commitment Dedicated to provide with the best possible rail service. Our commitment to our
  • 146.
    P a ge | 146 customers is our priority. Government Contribution GRT will provide a rail network that keeps cities moving and communities connected at an acceptable cost to the taxpayer, and ensures passengers benefit from a high-performing, affordable railway. Contribution to Environment Travelling by train is less carbon-intensive than travelling by car. Rail is the environmentally friendly and socially responsible travel option.
  • 147.
    P a ge | 147 APPENDICES
  • 148.
    P a ge | 148 Appendix 1: Sample Size Computation Slovin’s Formula Where: n = sample size N = population (2014) e = margin of error (5%) = 400
  • 149.
    P a ge | 149 Appendix 2: Survey Question
  • 150.
    P a ge | 150
  • 151.

    P a ge | 151 Appendix 3: Survey Results
  • 152.
    P a ge | 152
  • 153.
    P a ge | 153
  • 154.
    P a ge | 154
  • 155.
    P a ge | 155
  • 156.
    P a ge | 156
  • 157.
    P a ge | 157
  • 158.
    P a ge | 158
  • 159.
    P a ge | 159
  • 160.
    P a ge | 160
  • 161.
    P a ge | 161
  • 162.
    P a ge | 162 6.07% 93.93% h. If you are from Bayambang: Yes No
  • 163.
    P a ge | 163 Appendix 4: Articles of Partnership ARTICLES OF GENERAL PARTNERSHIP KNOW ALL MEN BY THESE PRESENTS: That we, Christian O. Bacoy, Filipino, single; Danica C. Balisi, Filipino, single; Jonathan Ray DL. Rubico, Filipino, single, all of legal age and residents of Antipolo City have covenanted to establish a partnership from this date, in accordance with existing laws, AND WE HEREBY CERTIFY: 1. That the names, surnames, and addresses of the respective partners are as follows: Name Address Christian O. Bacoy Brgy. Dalig, Antipolo City Danica C. Balisi Brgy. San Jose, Antipolo City Jonathan Ray DL. Rubico Brgy. San Luis, Antipolo City 2. That the name of this partnership shall be Gicha Ressha Train Company, and it shall exist for __ years from the execution of this instrument, with the right of transfer or retirement of any partner provided written notice and approval are made to and by the others; 3. That the capital of this partnership shall be ten billion pesos, (Php 10,000,000,000) broken down, in contributions, as follows:
  • 164.
    P a ge | 164 Name Contribution Christian O. Bacoy Php 3,020,000,000.00 Danica C. Balisi Php 3,020,000,000.00 Jonathan Ray DL. Rubico Php 3,020,000,000.00 4. That the purposes for which this partnership is established are as follows: GRT Company is planning on reviving the railroad from Tutuban to Dagupan in order to help the passengers to go along those provinces in a fast way with cheaper price. The company aims to make the railroad more suitable to passengers especially to the low - income class family and also to allow traveling of goods coming from these provinces. 5. That the partnership shall be under the management and supervision of General Manager, who shall perform such acts and enter into transactions as may be necessary, in the name of the partnership, for the conduct of its business; and who shall receive a monthly salary of _______ 6. That the profits and losses shall be divided among the partners pro rata, in proportion to their respective contributions, as set forth in paragraph 3 hereof. Miscellaneous Section IN WITNESS WHEREOF, we have hereunto affixed our signatures this __ day of _____, _____ at _________, Philippines. Name Signature WITNESSES:
  • 165.
    P a ge | 165 Name Signature ACKNOWLEDGMENT REPUBLIC OF THE PHILIPPINES ) CITY/PROVINCE OF X ) SS. Municipality of x ) BEFORE ME, a Notary Public for and in the Province/City of Name Of City/Province, this xth day of Month, 9999, personally came and appeared the following persons with their corresponding Community Tax Certificates: NAMES COMM. TAX. CERT. NO. DATE/PLACE ISSUED Known to me and to me known to be the same persons who executed the foregoing instrument and acknowledged before me that the same is their free and voluntary act and deed, and that of
  • 166.
    P a ge | 166 the corporation they represent. WITNESS MY HAND AND NOTARIAL SEAL Notary Public Doc. No.: __________ Page No.: __________ Book No.: __________ Series of __________
  • 167.
    P a ge | 167 Appendix 5: Minimum Wage Rates
  • 168.
    P a ge | 168 Appendix 6: SSS Contribution Table Source: http://www.bles.dole.gov.ph/PUBLICATIONS/Current%20Labor%20Statistics/STATISTICAL%20TABLE S/PDF/tab24.pdf
  • 169.
    P a ge | 169 Appendix 6: SSS Table Contribution Source: Social Security System Official Website, 2014 http://www.ssscontributiontable.com/
  • 170.
    P a ge | 170 Appendix 7: PhilHealth Contribution Table *Employee share represents half of the total monthly premium while the other half is shouldered by the employer. Source: http://www.philhealth.gov.ph/partners/employers/contri_tbl.html
  • 171.
    P a ge | 171 Appendix 8: Pag-Ibig Fund Contribution Source: http://amaranthbiz.wordpress.com/2013/01/16/sss-philhealth-pag-ibig-hdmf-contributions/
  • 172.
    P a ge | 172 Appendix 9: Tax Rate What is the income tax rate in the Philippines? For individuals earning purely compensation income and those engaged in business and practice of profession, the applicable tax rate table is as follows: Taxable Income Tax Rate More than But less than 0 P10,000 5% P10,000 P30,000 P500 + 10% of the Excess over P10,000 P30,000 P70,000 P2,500 + 15% of the Excess over P30,000 P70,000 P140,000 P8,500 + 20% of the Excess over P70,000 P140,000 P250,000 P22,500 + 25% of the Excess over P140,000 P250,000 P500,000 P50,000 + 30% of the Excess over P250,000 P500,000 P125,000 + 32% of the Excess over P500,000 in 2000 and onward  For domestic corporations, the corporate tax rate is 30% of the Net taxable income from all sources starting January 1, 2009.  For proprietary educational institutions and non-stock, non-profit hospitals, the tax rate is 10% of the Net taxable income, provided that the gross income from unrelated trade, business or other activity does not exceed 50% of the total gross income.  For GOCCs, agencies & instrumentalities, the tax rate is 32% of the Net taxable income from all sources.  For all taxable partnerships, the tax rate is also 32% of the Net taxable income from all sources.  International Carriers are taxed 2.5% on their Gross Philippine Billings.  For Regional Operating Headquarters (ROHQ), the tax rate is 10% of Taxable Income. Source: http://www.pinoymoneytalk.com/income-tax-rates-exemptions/#sthash.HPejKA9S.dpuf
  • 173.
    P a ge | 173 Appendix 10: Projected Demand Year Target Population % of Population who are willing to ride train Market Acceptability Potential Target Market Percentage Frequency Annual Demand Total Annual DemandEvery Week Once a month Once a year Others Every Week (54) Once a month (12) Once a year (1) Others (4) 2015 898,402 47.25% 71.25% 302,452.77 20.50% 35.00% 28.50% 16.00% 3,348,152.19 1,270,301.64 86,199.04 193,569.77 4,898,222.65 2016 915,472 47.25% 71.25% 308,199.38 20.50% 35.00% 28.50% 16.00% 3,411,767.08 1,294,437.38 87,836.82 197,247.60 4,991,288.88 2017 932,866 47.25% 71.25% 314,055.16 20.50% 35.00% 28.50% 16.00% 3,476,590.66 1,319,031.69 89,505.72 200,995.30 5,086,123.37 2018 950,590 47.25% 71.25% 320,022.21 20.50% 35.00% 28.50% 16.00% 3,542,645.88 1,344,093.29 91,206.33 204,814.22 5,182,759.71 2019 968,652 47.25% 71.25% 326,102.63 20.50% 35.00% 28.50% 16.00% 3,609,956.15 1,369,631.06 92,939.25 208,705.69 5,281,232.15
  • 174.
    P a ge | 174 Appendix 11: Price Computation for the Year 2015 – 2019 2015 Material Amount 2014supply unit cost Train 153,750,875 1,084,644 141.7524 Direct Labor 2,731,560 1,084,644 2.518393 Overhead Cost Power 1,398,592.04 1,084,644 1.289448 Water 360,363.60 1,084,644 0.332241 Total 145.8925 2016 Material amount 2014supply unit cost Train 153,750,875 1,084,644 141.7524 Direct Labor 2,731,560 1,084,644 2.518393 Overhead Cost Power 1,468,521.64 1,084,644 1.35392 Water 378,381.68 1,084,644 0.348853 Total 145.9736 2017 Material amount 2014supply unit cost Train 153,750,875 1,084,644 141.7524 Direct Labor 2,731,560 1,084,644 2.518393 Overhead Cost Power 1,541,947.72 1,084,644 1.421616 Water 397,300.87 1,084,644 0.366296 Total 146.0587 2018 Material amount 2014supply unit cost Train 153,750,875 1,084,644 141.7524 Direct Labor 2,731,560 1,084,644 2.518393 Overhead Cost Power 1,619,045.11 1,084,644 1.492697 Water 417,165.91 1,084,644 0.384611 Total 146.1481 2019 Material amount 2014supply unit cost Train 153,750,875 1,084,644 141.7524 Direct Labor 2,731,560 1,084,644 2.518393 Overhead Cost Power 1,699,997.36 1,084,644 1.567332 Water 438,024.81 1,084,644 0.403842 Total 146.242
  • 175.
    P a ge | 175 Appendix 12: Sales Computation for the Year 2015 – 2019 2015 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 3,615,480 20.78% 751,432 - - - - Bocaue 3,615,480 5.69% 205,680 180.00 37,022,407.59 3,966,686.53 33,055,721.07 Malolos 3,615,480 10.48% 378,812 180.00 68,186,157.22 7,305,659.70 60,880,497.52 TOTAL 105,208,564.82 11,272,346.23 93,936,218.59 2016 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 3,615,480 20.78% 826,574.93 - - - - Bocaue 3,615,480 5.69% 226,248.05 180.00 40,724,648.35 4,363,355.18 36,361,293.17 Malolos 3,615,480 10.48% 416,693.18 180.00 75,004,772.94 8,036,225.67 66,968,547.27 San Fernando 3,615,480 9.44% 73,148 230.00 16,824,040.00 1,802,575.71 15,021,464.29 Angeles 3,615,480 14.70% 109,419 230.00 25,166,370.00 2,696,396.79 22,469,973.21 Capas 3,615,480 10.86% 127,467 280.00 35,690,760.00 3,824,010.00 31,866,750.00 TOTAL 193,410,591.30 20,722,563.35 172,688,027.94 2017 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,067,415 20.78% 834,840.68 - - - - Bocaue 4,067,415 5.69% 228,510.53 180.00 41,131,894.84 4,406,988.73 36,724,906.11 Malolos 4,067,415 10.48% 420,860.11 180.00 75,754,820.67 8,116,587.93 67,638,232.74
  • 176.
    P a ge | 176 San Fernando 4,067,415 9.44% 73,879.48 230.00 16,992,280.40 1,820,601.47 15,171,678.93 Angeles 4,067,415 14.70% 110,513.19 230.00 25,418,033.70 2,723,360.75 22,694,672.95 Capas 4,067,415 10.86% 128,741.67 280.00 36,047,667.60 3,862,250.10 32,185,417.50 tarlac 4,067,415 11.03% 448,737 330.00 148,083,171.61 15,866,054.10 132,217,117.51 Bayambang 4,067,415 6.07% 246,803 380.00 93,785,307.45 10,048,425.80 83,736,881.65 Dagupan 4,067,415 10.95% 445,388 430.00 191,516,646.54 20,519,640.70 170,997,005.84 TOTAL 628,729,822.81 67,363,909.59 561,365,913.22 2018 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,293,383 20.78% 843,189.08 - - - - Bocaue 4,293,383 5.69% 230,795.63 180.00 41,543,213.79 4,451,058.62 37,092,155.17 Malolos 4,293,383 10.48% 425,068.72 180.00 76,512,368.88 8,197,753.81 68,314,615.07 San Fernando 4,293,383 9.44% 74,618.27 230.00 17,162,203.20 1,838,807.49 15,323,395.72 Angeles 4,293,383 14.70% 111,618.32 230.00 25,672,214.04 2,750,594.36 22,921,619.68 Capas 4,293,383 10.86% 130,029.09 280.00 36,408,144.28 3,900,872.60 32,507,271.68 tarlac 4,293,383 11.03% 453,224.25 330.00 149,564,003.33 16,024,714.64 133,539,288.68 Bayambang 4,293,383 6.07% 249,271.48 380.00 94,723,160.52 10,148,910.06 84,574,250.47 Dagupan 4,293,383 10.95% 449,841.43 430.00 193,431,813.01 20,724,837.11 172,706,975.90 TOTAL 635,017,121.04 68,037,548.68 566,979,572.35 2019 Service Capacity Percentage Sales in Units Price Sales - VAT Inclusive 12% Sales - VAT exclusive Tutuban 4,519,350 20.78% 851,620.97 - - - -
  • 177.
    P a ge | 177 Bocaue 4,519,350 5.69% 233,103.59 180.00 41,958,645.92 4,495,569.21 37,463,076.72 Malolos 4,519,350 10.48% 429,319.40 180.00 77,277,492.57 8,279,731.35 68,997,761.22 San Fernando 4,519,350 9.44% 75,364.46 230.00 17,333,825.24 1,857,195.56 15,476,629.68 Angeles 4,519,350 14.70% 112,734.51 230.00 25,928,936.18 2,778,100.30 23,150,835.87 Capas 4,519,350 10.86% 131,329.38 280.00 36,772,225.72 3,939,881.33 32,832,344.39 tarlac 4,519,350 11.03% 457,756.50 330.00 151,059,643.36 16,184,961.79 134,874,681.57 Bayambang 4,519,350 6.07% 251,764.19 380.00 95,670,392.13 10,250,399.16 85,419,992.97 Dagupan 4,519,350 10.95% 454,339.84 430.00 195,366,131.14 20,932,085.48 174,434,045.66 TOTAL 641,367,292.25 68,717,924.17 572,649,368.08
  • 178.
    P a ge | 178 Appendix 13: Purchases for 2015 2015 Toilet Fixtures (Station) Item Unit Cost Quantity/Supplier Total Cost Life span Depreciation Cost 1. Urinal 1 pcs 2,895 18/ ACE Hardware 52,100 20 2. Toilet bowl w/ Spray 1 pcs 3,050 36/ ACE Hardware 109,800 20 Total 161,900 8095 Office Equipment Item Unit Unit Cost Quantity (Annual)/ Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 4,500 8/ Pc Gilmore Computer Center 36,000 5 years 7200 2. 3 in 1 Printer 1 Unit 2,000 2/ Pc Gilmore Computer Center 4,000 5 years 800 3. Aircon 1 Unit 12,000 3/ Pc Gilmore Computer Center 36,000 10 years 3,600 4. Fax Machine 1 Unit 5,800 1/villman 5,800 5 years 1160 5.Water Dispenser 1 unit 4,798 1/ Abenson 4,798 5 years 959.6 6. Refrigirator 1 unit 7,695 1/ Lazada 7,695 10 years 769.5 7. CCTV Camera 1 Package 1,180 10/ CDR King 11,800 5 years 2360 Total 106,093 16,849.10 Office Supplies Item Unit Unit Cost Quantity (Annual)/ Supply Total cost Life Span Depreciation Cost 1. Black Ballpen 25.00 pcs/box 90 6/ Office 1 e-shop 540
  • 179.
    P a ge | 179 2. Paper Clips 100 pcs/ box 13.75 1/ Office 1 e-shop 13.75 3. Bond paper (A4) 1 Rim 140 1/Office 1 e-shop 140 4. Record Book (300 leaves) 1 pc 41.25 4/Office 1 e-shop 165 5. Folder (Long) 1 2.5 10/Office 1 e-shop 25 6. Marker 12 pcs/box 96 1/ Office 1 e-shop 96 7. Stapler 1 pc 45 2/ Office 1 e-shop 90 8. Staple wire 1 box 4.83 4/ Office 1 e-shop 19.32 9. Staple Remover 1 pc 12 2/ Office 1 e-shop 24 10. Journal 4 books/ set 400 1/Office 1 e-shop 400 11. Ink for Printer 1 set 1,200.00 1/ Office 1 e-shop 1,200.00 12. Paper roll 1 roll 8.75 80/ Office 1 e-shop 700 Total 3413.07 Office Furnitures Item Unit Cost Quantity/Supplier Total Cost Life span Depreciation Cost 1. Office Desk 1 2,500 7/ ADB Office Furniture 17,500 5 2. Office Chair 1 650 7/ ADB Office Furniture 4,550 5 3. Filing Cabinet 1 4,300 1/ ADB Office Furniture 4,300 15 4. Monobloc 1 320 3/ ADB Office Furniture 640 10 5. Fire Extinguisher 1 7,800 3/ ADB Office Furniture 23,400 10 6. Storage Cabinet 1 1,999 6/ ADB Office Furniture 11,994 10 Total 62,384 Service Supplies (Direct Materials) Item Unit Cost Quantity/Supplier Total Cost Life span Depreciation Cost
  • 180.
    P a ge | 180 1. Train 1 pc 157,750,875 9/ Japan Railway System 1,419,757,875 50 years 2. Railway 1 km 34,400,000 214/ Japan Railway System 7,361,600,000 50 years 3. Clock 1 pc 295 18/ Western Digital 5310 5 years 4. Automatic Card Reader 1 pcs 150,000 72/ 10,800,000 15 years Total 8,792,163,185 176,348,219.50 Janitorial and Comfort Room Supplies and Expenses Item Unit Cost Quantity/Supplier Total Cost Life span Depreciation Cost Air Freshener 1 piece 140 36 5040 Broom 1 piece 120 18 2160 Stickbroom 1 piece 10 9 90 Dust pan 1 piece 80 18 1440 Floor Mop 1 piece 180 9 1620 Garbage Bags 1 piece 10 225 2250 Garbage Cans 1 piece 100 18 1800 Liquid Soap (Exel) 1 bottle 60 90 5400 Hand Wash 1 bottle 35 36 1260 Toilet Paper 1 roll 10 450 4500 Total 25560 Total Annual Expense 306720 Uniform Expense Item Unit Cost Quantity/Supplier Total Cost Life span Depreciation Cost Train driver 1 9 500 4500
  • 181.
    P a ge | 181 Appendix 14: Purchases for 2016 2016 Toilet Fixtures (Station) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Urinal 1 pc 18/ ACE Hardware 20 years 2. Toilet bowl w/ Spray 1 pc 36/ ACE Hardware 20 years 5490 Total Office Equipment Item Unit Unit Cost Quantity (Annual)/ Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 8/ Pc Gilmore Computer Center 5 years 2. 3 in 1 Printer 1 Unit 2/ Pc Gilmore Computer Center 5 years 3. Aircon 1 Unit 3/ Pc Gilmore Computer Center 10 years 4. Fax Machine 1 Unit 1/villman 5 years 5.Water Dispenser 1 unit 1/ Abenson 5 years 6. Refrigirator 1 unit 1/ Lazada 10 years 7. CCTV Camera 1 Package 10/ CDR King 5 years Total Office Supplies Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Black Ballpen 25.00 pcs/box 91.8 6/ Office 1 e-shop 550.8 2. Paper Clips 100 pcs/ box 14.025 1/ Office 1 e-shop 14.025
  • 182.
    P a ge | 182 3. Bond paper (A4) 1 Rim 142.8 1/Office 1 e-shop 142.8 4. Record Book (300 leaves) 1 pc 42.075 4/Office 1 e-shop 168.3 5. Folder (Long) 1 2.55 10/Office 1 e-shop 25.5 6. Marker 12 pcs/box 97.92 1/ Office 1 e-shop 97.92 7. Stapler 1 pc 45.9 2/ Office 1 e-shop 91.8 8. Staple wire 1 box 4.9266 4/ Office 1 e-shop 19.7064 9. Staple Remover 1 pc 12.24 2/ Office 1 e-shop 24.48 10. Journal 4 books/ set 408 1/Office 1 408 11. Ink for Printer 1 set 1,224.00 1/ Office 1 e-shop 1,224.00 12. Paper roll 1 roll 8.925 80/ Office 1 e-shop 714 Total 3481.3314 Office Furnitures Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Office Desk 1 7/ ADB Office Furniture 5 years 2. Office Chair 1 7/ ADB Office Furniture 5 years 3. Filing Cabinet 1 1/ ADB Office Furniture 15 years 4. Monobloc 1 3/ ADB Office Furniture 10 years 5. Fire Extinguisher 1 3/ ADB Office Furniture 10 years 6. Storage Cabinet 1 6/ ADB Office Furniture 10 years Total Service Supplies (Direct Materials) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Train 1 pc 9/ Japan Railway System 50 years 2. Railway 1 km 214/ Japan Railway System 50 years
  • 183.
    P a ge | 183 3. Clock 1 pc 18/ Western Digital 5 years 4. Automatic Card Reader 1 pcs 72 pcs 15 years Total Janitorial and Comfort Room Supplies and Expenses Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost Air Freshener piece 142.8 36 5140.8 Broom piece 122.4 18 2203.2 Stickbroom piece 10.2 9 91.8 Dust pan piece 81.6 18 1468.8 Floor Mop piece 183.6 9 1652.4 Garbage Bags piece 10.2 225 2295 Garbage Cans piece 102 18 1836 Liquid Soap (Exel) bottle 61.2 90 5508 Hand Wash bottle 35.7 36 1285.2 Toilet Paper roll 10.2 450 4590 Total 26071.2 Total Annual Expense 312854.4 Uniform Expense Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost Train driver 9 500 4500
  • 184.
    P a ge | 184 Appendix 15: Purchases for 2017 2017 Toilet Fixtures (Station) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Urinal 1 pcs 18/ ACE 20 2. Toilet bowl w/ Spray 1 pcs 36/ ACE 20 Total 161,900 Office Equipment Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 8/ Pc Gilmore Computer Center 5 years 2. 3 in 1 Printer 1 Unit 2/ Pc Gilmore Computer Center 5 years 3. Aircon 1 Unit 3/ Pc Gilmore Computer Center 10 years 4. Fax Machine 1 Unit 1/villman 5 years 5.Water Dispenser 1 unit 1/ Abenson 5 years 6. Refrigirator 1 unit 1/ Lazada 10 years 7. CCTV Camera 1 Package 10/ CDR King 5 years Total Office Supplies Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Black Ballpen 25.00 pcs/box 93.636 6/ Office 1 561.816 2. Paper Clips 100 pcs/ box 14.3055 1/ Office 1 14.3055
  • 185.
    P a ge | 185 3. Bond paper (A4) 1 Rim 145.656 1/Office 1 145.656 4. Record Book (300 leaves) 1 pc 42.9165 4/Office 1 171.666 5. Folder (Long) 1 2.601 10/Office 1 26.01 6. Marker 12 pcs/box 99.8784 1/ Office 1 99.8784 7. Stapler 1 pc 46.818 2/ Office 1 93.636 8. Staple wire 1 box 5.02513 4/ Office 1 20.100528 9. Staple Remover 1 pc 12.4848 2/ Office 1 24.9696 10. Journal 4 books/ set 416.16 1/Office 1 416.16 11. Ink for Printer 1 set 1,248.48 1/ Office 1 1,248.48 12. Paper roll 1 roll 9.1035 80/ Office 1 728.28 Total 3550.95803 Office Furnitures Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Office Desk 1 7/ ADB Office Furniture 5 2. Office Chair 1 7/ ADB Office Furniture 5 3. Filing Cabinet 1 1/ ADB Office Furniture 15 4. Monobloc 1 3/ ADB Office Furniture 10 5. Fire Extinguisher 1 3/ ADB Office Furniture 10 6. Storage Cabinet 1 6/ ADB Office Furniture 10 Total Service Supplies (Direct Materials) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Train 1 pc 9/ Japan Railway System 50 years 2. Railway 1 km 214/ Japan Railway System 50 years
  • 186.
    P a ge | 186 3. Clock 1 pc 18/ Western Digital 5 years 4. Automatic Card Reader 1 pcs 72 pcs 15 years Total Janitorial and Comfort Room Supplies and Expenses Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost Air Freshener piece 145.656 36 5243.616 Broom piece 124.848 18 2247.264 Stickbroom piece 10.404 9 93.636 Dust pan piece 83.232 18 1498.176 Floor Mop piece 187.272 9 1685.448 Garbage Bags piece 10.404 225 2340.9 Garbage Cans piece 104.04 18 1872.72 Liquid Soap (Exel) bottle 62.424 90 5618.16 Hand Wash bottle 36.414 36 1310.904 Toilet Paper roll 10.404 450 4681.8 Total 26592.624 Total Annual Expense 319111.488 Uniform Expense Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost train driver 9 500 4500
  • 187.
    P a ge | 187 Appendix 16: Purchases for 2018 2017 Toilet Fixtures (Station) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Urinal 1 pcs 18/ ACE Hardware 20 2. Toilet bowl w/ Spray 1 pcs 36/ ACE Hardware 20 Total Office Equipment Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 8/ Pc Gilmore Computer Center 5 years 2. 3 in 1 Printer 1 Unit 2/ Pc Gilmore Computer Center 5 years 3. Aircon 1 Unit 3/ Pc Gilmore Computer Center 10 years 4. Fax Machine 1 Unit 1/villman 5 years 5.Water Dispenser 1 unit 1/ Abenson 5 years 6. Refrigirator 1 unit 1/ Lazada 10 years 7. CCTV Camera 1 Package 10/ CDR King 5 years Total Office Supplies Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Black Ballpen 25.00 pcs/box 95.50872 6/ Office 1 e-shop 573.05232 2. Paper Clips 100 pcs/ box 14.59161 1/ Office 1 e-shop 14.59161
  • 188.
    P a ge | 188 3. Bond paper (A4) 1 Rim 151.540502 1/Office 1 e-shop 151.540502 4. Record Book (300 leaves) 1 pc 43.77483 4/Office 1 e-shop 175.09932 5. Folder (Long) 1 2.65302 10/Office 1 e-shop 26.5302 6. Marker 12 pcs/box 101.875968 1/ Office 1 e-shop 101.875968 7. Stapler 1 pc 47.75436 2/ Office 1 e-shop 95.50872 8. Staple wire 1 box 5.12563464 4/ Office 1 e-shop 20.5025386 9. Staple Remover 1 pc 12.734496 2/ Office 1 e-shop 25.468992 10. Journal 4 books/ set 424.4832 1/Office 1 424.4832 11. Ink for Printer 1 set 1,273.45 1/ Office 1 e-shop 1,273.45 12. Paper roll 1 roll 9.28557 80/ Office 1 e-shop 742.8456 Total 3624.94857 Office Furnitures Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Office Desk 1 7/ ADB Office Furniture 5 2. Office Chair 1 7/ ADB Office Furniture 5 3. Filing Cabinet 1 1/ ADB Office Furniture 15 4. Monobloc 1 3/ ADB Office Furniture 10 5. Fire Extinguisher 1 3/ ADB Office Furniture 10 6. Storage Cabinet 1 6/ ADB Office Furniture 10 Total Service Supplies (Direct Materials) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Train 1 pc 9/ Japan Railway System 50 years 2. Railway 1 km 214/ Japan Railway System 50 years
  • 189.
    P a ge | 189 3. Clock 1 pc 18/ Western Digital 5 years 4. Automatic Card Reader 1 pcs 72 pcs 15 years Total Janitorial and Comfort Room Supplies and Expenses Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost Air Freshener 1 piece 148.56912 36 5348.48832 Broom 1 piece 127.34496 18 2292.20928 Stickbroom 1 piece 10.61208 9 95.50872 Dust pan 1 piece 84.89664 18 1528.13952 Floor Mop 1 piece 191.01744 9 1719.15696 Garbage Bags 1 piece 10.61208 225 2387.718 Garbage Cans 1 piece 106.1208 18 1910.1744 Liquid Soap (Exel) 1 bottle 63.67248 90 5730.5232 Hand Wash 1 bottle 37.14228 36 1337.12208 Toilet Paper 1 roll 10.61208 450 4775.436 Total 27124.47648 Total Annual Expense 325493.7178 Uniform Expense Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost train driver 9 500 4500
  • 190.
    P a ge | 190 Appendix 17: Purchases for 2019 2019 Toilet Fixtures (Station) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Urinal 1 pcs 18/ ACE Hardware 20 2. Toilet bowl w/ Spray 1 pcs 36/ ACE Hardware 20 Total Office Equipment Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Computer Set 1 Set 8/ Pc Gilmore Computer Center 5 years 2. 3 in 1 Printer 1 Unit 2/ Pc Gilmore Computer Center 5 years 3. Aircon 1 Unit 3/ Pc Gilmore Computer Center 10 years 4. Fax Machine 1 Unit 1/villman 5 years 5.Water Dispenser 1 unit 1/ Abenson 5 years 6. Refrigirator 1 unit 1/ Lazada 10 years 7. CCTV Camera 1 Package 10/ CDR King 5 years Total Office Supplies Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Black Ballpen 25.00 pcs/box 97.4188944 6/ Office 1 e-shop 584.5133664 2. Paper Clips 100 pcs/ box 14.8834422 1/ Office 1 e-shop 14.8834422 3. Bond paper (A4) 1 Rim 154.571312 1/Office 1 e-shop 154.5713124
  • 191.
    P a ge | 191 4. Record Book (300 leaves) 1 pc 44.6503266 4/Office 1 e-shop 178.6013064 5. Folder (Long) 1 2.7060804 10/Office 1 e-shop 27.060804 6. Marker 12 pcs/box 103.913487 1/ Office 1 e-shop 103.9134874 7. Stapler 1 pc 48.7094472 2/ Office 1 e-shop 97.4188944 8. Staple wire 1 box 5.22814733 4/ Office 1 e-shop 20.91258933 9. Staple Remover 1 pc 12.9891859 2/ Office 1 e-shop 25.97837184 10. Journal 4 books/ set 432.972864 1/Office 1 e-shop 432.972864 11. Ink for Printer 1 set 1,298.92 1/ Office 1 e-shop 1,298.92 12. Paper roll 1 roll 9.4712814 80/ Office 1 e-shop 757.702512 Total 3697.447542 Office Furnitures Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Office Desk 1 7/ ADB Office Furniture 5 2. Office Chair 1 7/ ADB Office Furniture 5 3. Filing Cabinet 1 1/ ADB Office Furniture 15 4. Monobloc 1 3/ ADB Office Furniture 10 5. Fire Extinguisher 1 3/ ADB Office Furniture 10 6. Storage Cabinet 1 6/ ADB Office Furniture 10 Total Service Supplies (Direct Materials) Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost 1. Train 1 pc 9/ Japan Railway System 50 years 2. Railway 1 km 214/ Japan Railway System 50 years 3. Clock 1 pc 18/ Western Digital 5 years
  • 192.
    P a ge | 192 4. Automatic Card Reader 1 pcs 72 pcs 15 years Total Janitorial and Comfort Room Supplies and Expenses Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost Air Freshener piece 151.5405024 36 5455.458086 Broom piece 129.8918592 18 2338.053466 Stickbroom piece 10.8243216 9 97.4188944 Dust pan piece 86.5945728 18 1558.70231 Floor Mop piece 194.8477888 9 1753.630099 Garbage Bags piece 10.8243216 225 2435.47236 Garbage Cans piece 108.243216 18 1948.377888 Liquid Soap (Exel) bottle 64.9459296 90 5845.133664 Hand Wash bottle 37.88512256 36 1363.864412 Toilet Paper roll 10.8243216 450 4870.94472 Total 27667.0559 Total Annual Expense 332004.6708 Uniform Expense Item Unit Cost Quantity/Supplier Total Cost Life Span Depreciation Cost train driver 9 500 4500
  • 193.
    P a ge | 193
