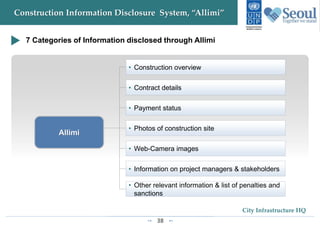

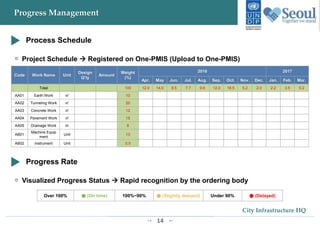

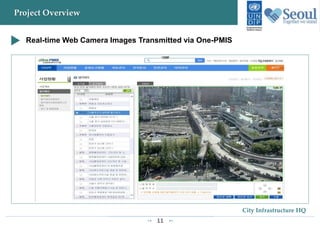

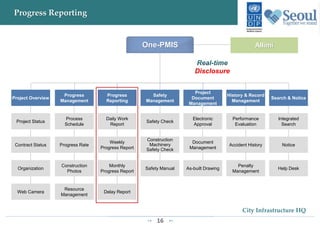

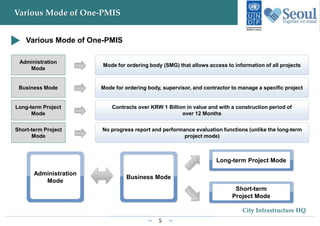

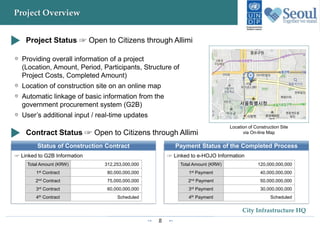

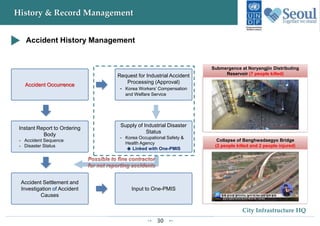

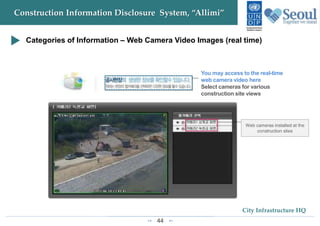

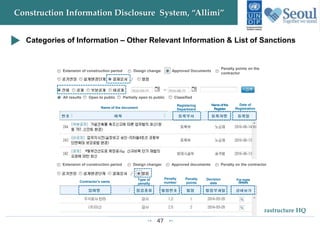

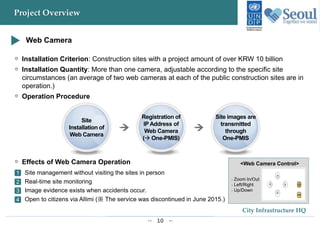

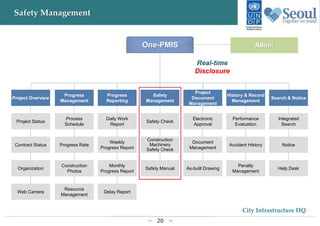

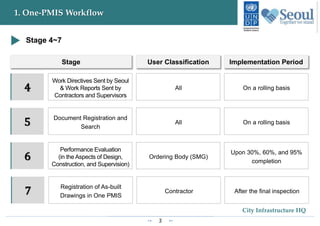

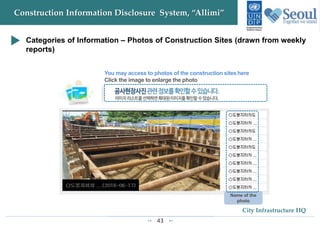

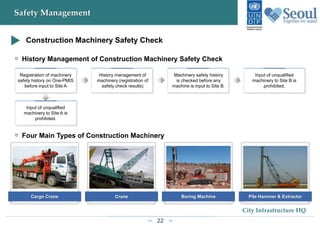

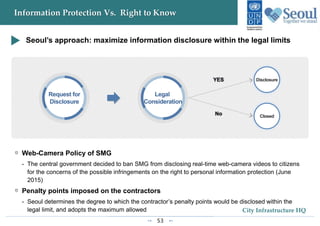

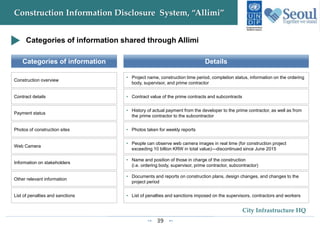

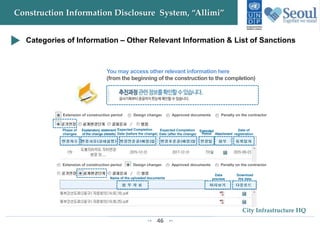

This document provides an overview of Seoul's One-PMIS (Project Management Information System) and the construction information disclosure system called "Allimi". It describes the workflow and user roles in One-PMIS, the various modules for project overview, progress management, reporting, safety management, and document management. It also explains the linked construction information disclosure system Allimi and how it provides public access to certain project documents and data.
