BASHUNDHARA
P R E S E N T E D B Y :
RESIDENTIAL
T A F S H I R U L A L A M M A H I - 1 2 1 9 0 1 0 1
J A K I R H O S S A I N - 1 2 1 9 0 1 0 2
A D N A N A H M E D - 1 2 1 9 0 1 0 3
F A R D I N F A R H A N S A K L A I N - 1 2 1 9 0 1 0 4
S A M I R A H C H A K S A R J I - 1 2 1 9 0 1 0 5
S H O R I F U L I S L A M - 1 2 1 9 0 1 0 6
S H A H A D A T H O S S A I N S A J J A D - 1 2 1 9 0 1 0 7
M D . W A L I D H O S S A I N - 1 2 1 9 0 1 3 8
AREA
ANALYSIS
R.E.H.A.B
R.E.H.A.B full-form Real Estate & Housing Association of
Bangladesh.
Established at 12 December in 1991,
Total Members 835 (till 26-jan-23).
Main Objectives of R.E.H.A.B
• To offer finest apartments in excellent locations to the
clients.
• To provide sound construction with aesthetic design to the
clients.
• To install best possible fitting and fixtures.
• To help solving the residential problem of Dhaka city.
• To perform social responsibility for a happy market.
Why real estate business or housing business developed in
Dhaka?
• Scarcity of open space in the important areas of the city.
• Rapid increase in population of Dhaka.
• Hazards of purchasing land.
• Hazards of construction of building.
• Decrease in the rate of bank interest.
• Price of land and apartments is increasing day by day.
• Rent of the apartment is comparatively higher than the rent of
privately constructed flats.

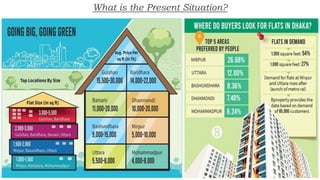

What is the Present Situation?

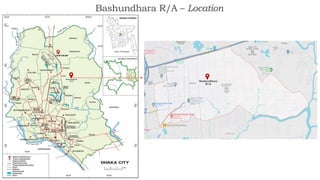

Bashundhara R/A – Location
Plot-746, Road-10, Block-I
Bashundhara
R/A Bashundhara
R/A

Bashundhara is situated in a residential area of Vatara Thana
in Dhaka, Bangladesh.
This area is developed by Bashundhara Group.
It is recognized as one of the most significant planned housing
areas in Bangladesh.
In the 1980s, the project was started by Ahmed Ikbal Sobhan.
In 2011 segments of the housing project was declared
unauthorized as they were in considerable flood flow zone
areas.
In 2014 a cabinet committee held a meeting to rechange the
Dhaka Detailed Area Plan (DAP) map to make the project
legalized.
The project was established on the area filled up low-lying
marshland areas. The project has been sold over 10,000 as of
2005 for the residential purpose with all other amenities.
Land value at 1988 per katha was 1 lakh, After 35 years it
increases 200% and the price is now almost 2 corer/katha.
Though the area is a little bit far from the current commercial
hubs like Motijheel and Gulshan areas, people still find it
suitable due to the peace, serenity and security of the
area.
Historical Context
Total area
3,346 acres
Build area
552.6 acres
Population
2,74,200
Why Bashundhara?
Accessibility to
the city and easy
commuting.
A better
neighborhood-
clean, peaceful
and green.
Countless
amenities.
Satisfaction of
the Inhabitants
Future
Development
Prospect
Prominent
educational
institutions,
hospital and
establishments.
Top-notch
security.
Available Features

Water
Supply
Problem
Electricity
Problem
Drainage
Problem
Security
Problem
Car
Parking
Problem
Traffic
Problem
The first and prime project popularly known as “Bashundhara”
near Bashundhara diplomatic zone has been developed on
Several hundred acres of land. In this residential area, 15
blocks are there and among them 13 (A to M) blocks are
already developed in planned and organized way and rest of
N,P blocks are on process to develop.
Bashundhara R/A
Facilities:
Problems:
The in habitants of Bashundhara R/A, confronting many
problem those are:-
Play Pen International School North South University
Jamuna Future Park
Bashundhara Convention Center
American University Bangladesh
Evercare Hospital Dhaka
North South University (NSU)
Independent University of Bangladesh (IUB)
American International University of Bangladesh (AIUB)
Play Pen International School
Evercare Hospital Dhaka
Jamuna Future Park
Bashundhara Convention Center

Bashundhara R/A – Master Plan
Plot-746, Road-10, Block-I

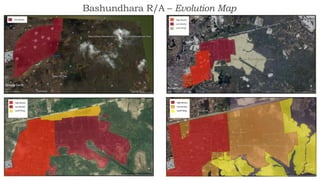

Bashundhara R/A – Evolution Map
Bashundhara R/A – Density Map
Bashundhara R/A – Development Map
Bashundhara R/A – Area Map

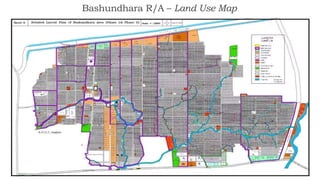

Bashundhara R/A – Land Use Map

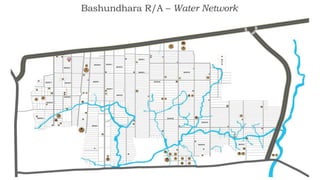

Bashundhara R/A – Water Network
Bashundhara R/A – Blocks Map

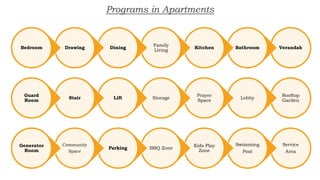

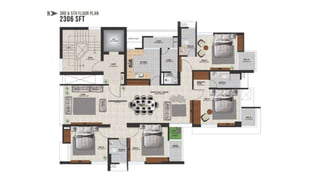

Programs in Apartments
Verandah
Bathroom
Kitchen
Family
Living
Dining
Drawing
Bedroom
Rooftop
Garden
Lobby
Prayer
Space
Storage
Lift
Stair
Guard
Room
Service
Area
Swimming
Pool
Kids Play
Zone
BBQ Zone
Parking
Community
Space
Generator
Room

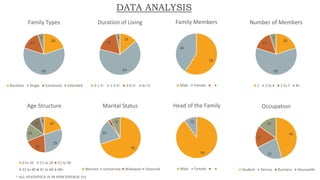

DATA ANALYSIS
20
60
15
5
Family Types
Bachelor Single Combined Extended
14
65
18
3
Duration of Living
0-1 Yr 1-3 Yr 3-6 Yr 6+ Yr
58
40
Family Members
Male Female
20
60
15
5
Number of Members
1 2 to 4 5 to 7 8+
20
29
20
16
11
4
Age Structure
0 to 10 11 to 20 21 to 30
31 to 40 41 to 60 60+
70
20
2
8
Marital Status
Married Unmarried Widowed Divorced
90
10
Head of the Family
Male Female
45
22
17
15
Occupation
Student Service Business Housewife
* ALL STATISTICS IS IN PERCENTAGE (%)

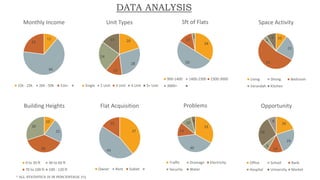

DATA ANALYSIS
11
66
23
Monthly Income
15k - 25k 26k - 50k 51k+
20
28
13
24
15
Unit Types
Single 2 Unit 3 Unit 4 Unit 5+ Unit
34
50
13
3
Sft of Flats
900-1400 1400-2300 2300-3000
3000+
10
23
54
4
9
Space Activity
Living Dining Bedroom
Verandah Kitchen
10
22
38
30
Building Heights
0 to 30 ft 40 to 60 ft
70 to 100 ft 100 - 120 ft
37
43
15
Flat Acquisition
Owner Rent Sublet
33
40
13
10
4
Problems
Traffic Drainage Electricity
Security Water
20
24
14
6
28
8
Opportunity
Office School Bank
Hospital University Market
* ALL STATISTICS IS IN PERCENTAGE (%)

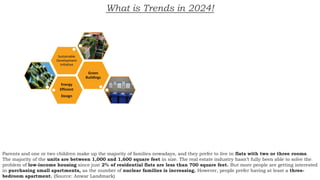

What is Trends in 2024!
Energy
Efficient
Design
Green
Buildings
Sustainable
Development
Initiative
Parents and one or two children make up the majority of families nowadays, and they prefer to live in flats with two or three rooms.
The majority of the units are between 1,000 and 1,600 square feet in size. The real estate industry hasn’t fully been able to solve the
problem of low-income housing since just 2% of residential flats are less than 700 square feet. But more people are getting interested
in purchasing small apartments, as the number of nuclear families is increasing. However, people prefer having at least a three-
bedroom apartment. (Source: Anwar Landmark)

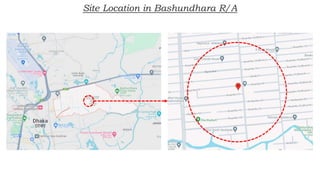

Site Location in Bashundhara R/A
Address: Plot-746, Road-10, Block-I, Bashundhara R/A, Dhaka
Land Size: 10 Katha
Size: 100’’-00 x 72’-00’
Area: 7200 sft
Orientation: North Facing
Current Situation: Pile Work Running
Site Information
Nearby Landmarks
Playpen International School
Center for Islamic Economics
Walton House

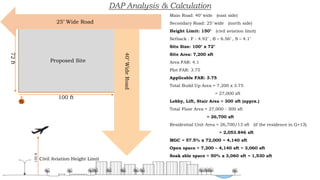

DAP Analysis & Calculation
150
ft
Civil Aviation Height Limit
40’
Wide
Road
25’ Wide Road
N
72
ft
100 ft
Main Road: 40’ wide (east side)
Secondary Road: 25’ wide (north side)
Height Limit: 150’ (civil aviation limit)
Setback : F - 4.92’ , B – 6.56’ , S – 4.1’
Site Size: 100’ x 72’
Site Area: 7,200 sft
Area FAR: 4.1
Plot FAR: 3.75
Applicable FAR: 3.75
Total Build Up Area = 7,200 x 3.75
= 27,000 sft
Lobby, Lift, Stair Area = 300 sft (apprx.)
Total Floor Area = 27,000 - 300 sft
= 26,700 sft
Residential Unit Area = 26,700/13 sft (if the residence in G+13)
= 2,053.846 sft
MGC = 57.5% x 72,000 = 4,140 sft
Open space = 7,200 – 4,140 sft = 3,060 sft
Soak able space = 50% x 3,060 sft = 1,530 sft
Proposed Site
2024 2018 2013
2010 2008 2004

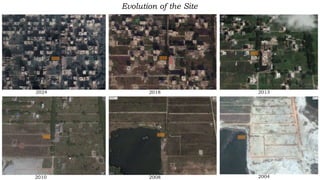

Evolution of the Site

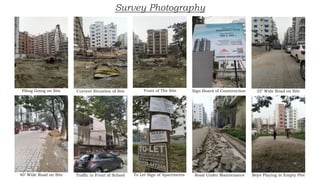

Survey Photography
Piling Going on Site Current Situation of Site Front of The Site Sign Board of Construction 25’ Wide Road on Site
40’ Wide Road on Site Traffic in Front of School To Let Sign of Apartments Road Under Maintenance Boys Playing in Empty Plot

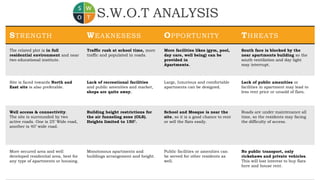

S.W.O.T ANALYSIS
STRENGTH WEAKNESESS OPPORTUNITY THREATS
The related plot is in full
residential environment and near
two educational institute.
Traffic rush at school time, more
traffic and populated in roads.
More facilities likes (gym, pool,
day care, well being) can be
provided in
Apartments.
South face is blocked by the
near apartments building so the
south ventilation and day light
may interrupt.
Site is faced towards North and
East site is also preferable.
Lack of recreational facilities
and public amenities and market,
shops are quite away.
Large, luxurious and comfortable
apartments can be designed.
Lack of public amenities or
facilities in apartment may lead to
less rent price or unsold of flats.
Well access & connectivity.
The site is surrounded by two
active roads. One is 25’ Wide road,
another is 40’ wide road.
Building height restrictions for
the air funneling zone (OLS).
Heights limited to 150’.
School and Mosque is near the
site, so it is a good chance to rent
or sell the flats easily.
Roads are under maintenance all
time, so the residents may facing
the difficulty of access.
More secured area and well
developed residential area, best for
any type of apartments or housing.
Monotonous apartments and
buildings arrangement and height.
Public facilities or amenities can
be served for other residents as
well.
No public transport, only
rickshaws and private vehicles.
This will lost interest to buy flats
here and house rent.

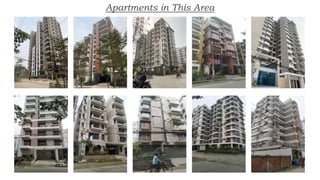

Apartments in This Area

Findings from the Survey
Most of the
developer
companies
builds 1800-
2200 sft
apartments.
Easily
accessible from
300 ft road, 100
ft road & Progoti
Shoroni.
Shopping mall,
Hospital and
Educational
Institutes are
available within
the range of 2
km.
Lack of luxurios
apartments in
this area.
Only a few
condominiums
are established
in this
residential area.
Studio
apartments/
Single unit can
be a good
chance.
Very few
apartments has
basement
parking, rest of
ground floor
parking.
Buildings are
mostly G+9 or
G+5, heights
from 60 ft to 110
ft.
Most of family
prefers
small/medium
apartments.
Lack of playing
or community
space, this can
be combined
with
apartments.
Problem of
parking,
electricity,
security and
water.
People likes the
apartments
which including
green, services
and energy
efficient design.
People not just
wants to live
also like to lead
a healthy life.
Basic
apartments
including 3 BHK
or 2 BHK.

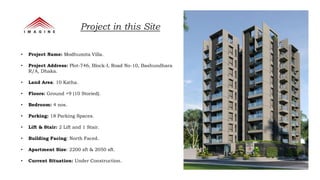

• Project Name: Modhumita Villa.
• Project Address: Plot-746, Block-I, Road No-10, Bashundhara
R/A, Dhaka.
• Land Area: 10 Katha.
• Floors: Ground +9 (10 Storied).
• Bedroom: 4 nos.
• Parking: 18 Parking Spaces.
• Lift & Stair: 2 Lift and 1 Stair.
• Building Facing: North Faced.
• Apartment Size: 2200 sft & 2050 sft.
• Current Situation: Under Construction.
Project in this Site

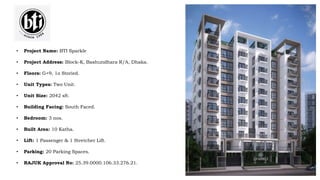

Developers Working in This Area
NEARBY RUNNING PROJECT
INFORMATION, 3DS & PLANS

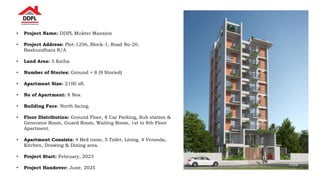

• Project Name: DDPL Mukter Mansion
• Project Address: Plot-1256, Block-1, Road No-20,
Bashundhara R/A
• Land Area: 5 Katha
• Number of Stories: Ground + 8 (9 Storied)
• Apartment Size: 2100 sft.
• No of Apartment: 8 Nos.
• Building Face: North facing.
• Floor Distribution: Ground Floor, 8 Car Parking, Sub station &
Generator Room, Guard Room, Waiting Room, 1st to 8th Floor
Apartment.
• Apartment Consists: 4 Bed room, 5 Toilet, Living, 4 Veranda,
Kitchen, Drawing & Dining area.
• Project Start: February, 2023
• Project Handover: June, 2025
• Project Name: Sheltech ELENA.
• Project Address: Plot # 353, Road # 10, Block # C, Basundhara
R/A, Dhaka.
• Type: 9 storied, (G+7) Residential building.
• Land Area: 7.50 katha.
• Road: 25'-0" (South).
• Total no. of units: 14.
• No. of Parking: 14.
• Building Face: South facing
• Unit type: Type A (+1800 sft.) Type B (+1800 sft.)
• No. of Lifts: 01.
• No. of Staircases: 01, with fire door.
• Project Status: Construction Running.
• Project Name: BTI Altus.
• Project Address: Plot # 266, Road # 5th Sarani, Block # L,
Bashundhara R/A.
• Building Facing: East Faced.
• Built Area: 5 katha.
• Number of Floors: G+8, 9 Storied.
• Parking: 8 Parking Spaces.
• Unit Type: Single Unit.
• Unit Size: 2300+ sft.
• Total Bedroom: 4 nos.
• RAJUK Approval No. 25.39.0000.106.33.1597.22
• Lift: 1, High Quality 8 Passenger.
• Project Name: Casa De Bengal.
• Project Address: Plot-2307 & 2308, Afroza Begum Road, Block-l,
Bashundhara R/A, Dhaka-1229.
• Land Size: 8 Katha.
• Unit Types: Two Unit.
• Unit Size: 2060 sft.
• Building Facing: South Faced.
• Bedroom: 3 nos.
• Status: Ongoing.
• Lift & Stair: 1 Passenger Lift & 1 Stair.
• Parking: 20 Parking Spaces.
• Floors: G+8, 9 Storied Building.
• Project Name: BTI Sparkle
• Project Address: Block-K, Bashundhara R/A, Dhaka.
• Floors: G+9, 1o Storied.
• Unit Types: Two Unit.
• Unit Size: 2042 sft.
• Building Facing: South Faced.
• Bedroom: 3 nos.
• Built Area: 10 Katha.
• Lift: 1 Passenger & 1 Stretcher Lift.
• Parking: 20 Parking Spaces.
• RAJUK Approval No: 25.39.0000.106.33.276.21.
R E F E R E N C E
• Bashundhara Housing
• Google Maps
• BTI
• Sheltech
• Imagine Properties
• Rehab BD
• Rajuk
• Anwar Land Mark
• Wikipedia
• Assure Group
• Red Bricks Bd
• The Business Standard
• Dhaka Tribune
• KHL
T H A N K Y O U

Bashundhara Residential _ Analysis and Case Study-MaHi.pptx

  • 1.
    BASHUNDHARA P R ES E N T E D B Y : RESIDENTIAL T A F S H I R U L A L A M M A H I - 1 2 1 9 0 1 0 1 J A K I R H O S S A I N - 1 2 1 9 0 1 0 2 A D N A N A H M E D - 1 2 1 9 0 1 0 3 F A R D I N F A R H A N S A K L A I N - 1 2 1 9 0 1 0 4 S A M I R A H C H A K S A R J I - 1 2 1 9 0 1 0 5 S H O R I F U L I S L A M - 1 2 1 9 0 1 0 6 S H A H A D A T H O S S A I N S A J J A D - 1 2 1 9 0 1 0 7 M D . W A L I D H O S S A I N - 1 2 1 9 0 1 3 8 AREA ANALYSIS
  • 2.
    R.E.H.A.B R.E.H.A.B full-form RealEstate & Housing Association of Bangladesh. Established at 12 December in 1991, Total Members 835 (till 26-jan-23). Main Objectives of R.E.H.A.B • To offer finest apartments in excellent locations to the clients. • To provide sound construction with aesthetic design to the clients. • To install best possible fitting and fixtures. • To help solving the residential problem of Dhaka city. • To perform social responsibility for a happy market. Why real estate business or housing business developed in Dhaka? • Scarcity of open space in the important areas of the city. • Rapid increase in population of Dhaka. • Hazards of purchasing land. • Hazards of construction of building. • Decrease in the rate of bank interest. • Price of land and apartments is increasing day by day. • Rent of the apartment is comparatively higher than the rent of privately constructed flats.
  • 3.
    What is thePresent Situation?
  • 4.
    Bashundhara R/A –Location Plot-746, Road-10, Block-I Bashundhara R/A Bashundhara R/A
  • 5.
    Bashundhara is situatedin a residential area of Vatara Thana in Dhaka, Bangladesh. This area is developed by Bashundhara Group. It is recognized as one of the most significant planned housing areas in Bangladesh. In the 1980s, the project was started by Ahmed Ikbal Sobhan. In 2011 segments of the housing project was declared unauthorized as they were in considerable flood flow zone areas. In 2014 a cabinet committee held a meeting to rechange the Dhaka Detailed Area Plan (DAP) map to make the project legalized. The project was established on the area filled up low-lying marshland areas. The project has been sold over 10,000 as of 2005 for the residential purpose with all other amenities. Land value at 1988 per katha was 1 lakh, After 35 years it increases 200% and the price is now almost 2 corer/katha. Though the area is a little bit far from the current commercial hubs like Motijheel and Gulshan areas, people still find it suitable due to the peace, serenity and security of the area. Historical Context Total area 3,346 acres Build area 552.6 acres Population 2,74,200
  • 6.
    Why Bashundhara? Accessibility to thecity and easy commuting. A better neighborhood- clean, peaceful and green. Countless amenities. Satisfaction of the Inhabitants Future Development Prospect Prominent educational institutions, hospital and establishments. Top-notch security. Available Features
  • 7.
    Water Supply Problem Electricity Problem Drainage Problem Security Problem Car Parking Problem Traffic Problem The first andprime project popularly known as “Bashundhara” near Bashundhara diplomatic zone has been developed on Several hundred acres of land. In this residential area, 15 blocks are there and among them 13 (A to M) blocks are already developed in planned and organized way and rest of N,P blocks are on process to develop. Bashundhara R/A Facilities: Problems: The in habitants of Bashundhara R/A, confronting many problem those are:- Play Pen International School North South University Jamuna Future Park Bashundhara Convention Center American University Bangladesh Evercare Hospital Dhaka North South University (NSU) Independent University of Bangladesh (IUB) American International University of Bangladesh (AIUB) Play Pen International School Evercare Hospital Dhaka Jamuna Future Park Bashundhara Convention Center
  • 8.
    Bashundhara R/A –Master Plan Plot-746, Road-10, Block-I
  • 9.
    Bashundhara R/A –Evolution Map
  • 10.
  • 11.
    Bashundhara R/A –Development Map
  • 12.
  • 13.
    Bashundhara R/A –Land Use Map
  • 14.
    Bashundhara R/A –Water Network
  • 15.
  • 16.
  • 17.
    DATA ANALYSIS 20 60 15 5 Family Types BachelorSingle Combined Extended 14 65 18 3 Duration of Living 0-1 Yr 1-3 Yr 3-6 Yr 6+ Yr 58 40 Family Members Male Female 20 60 15 5 Number of Members 1 2 to 4 5 to 7 8+ 20 29 20 16 11 4 Age Structure 0 to 10 11 to 20 21 to 30 31 to 40 41 to 60 60+ 70 20 2 8 Marital Status Married Unmarried Widowed Divorced 90 10 Head of the Family Male Female 45 22 17 15 Occupation Student Service Business Housewife * ALL STATISTICS IS IN PERCENTAGE (%)
  • 18.
    DATA ANALYSIS 11 66 23 Monthly Income 15k- 25k 26k - 50k 51k+ 20 28 13 24 15 Unit Types Single 2 Unit 3 Unit 4 Unit 5+ Unit 34 50 13 3 Sft of Flats 900-1400 1400-2300 2300-3000 3000+ 10 23 54 4 9 Space Activity Living Dining Bedroom Verandah Kitchen 10 22 38 30 Building Heights 0 to 30 ft 40 to 60 ft 70 to 100 ft 100 - 120 ft 37 43 15 Flat Acquisition Owner Rent Sublet 33 40 13 10 4 Problems Traffic Drainage Electricity Security Water 20 24 14 6 28 8 Opportunity Office School Bank Hospital University Market * ALL STATISTICS IS IN PERCENTAGE (%)
  • 19.
    What is Trendsin 2024! Energy Efficient Design Green Buildings Sustainable Development Initiative Parents and one or two children make up the majority of families nowadays, and they prefer to live in flats with two or three rooms. The majority of the units are between 1,000 and 1,600 square feet in size. The real estate industry hasn’t fully been able to solve the problem of low-income housing since just 2% of residential flats are less than 700 square feet. But more people are getting interested in purchasing small apartments, as the number of nuclear families is increasing. However, people prefer having at least a three- bedroom apartment. (Source: Anwar Landmark)
  • 20.
    Site Location inBashundhara R/A
  • 21.
    Address: Plot-746, Road-10,Block-I, Bashundhara R/A, Dhaka Land Size: 10 Katha Size: 100’’-00 x 72’-00’ Area: 7200 sft Orientation: North Facing Current Situation: Pile Work Running Site Information Nearby Landmarks Playpen International School Center for Islamic Economics Walton House
  • 22.
    DAP Analysis &Calculation 150 ft Civil Aviation Height Limit 40’ Wide Road 25’ Wide Road N 72 ft 100 ft Main Road: 40’ wide (east side) Secondary Road: 25’ wide (north side) Height Limit: 150’ (civil aviation limit) Setback : F - 4.92’ , B – 6.56’ , S – 4.1’ Site Size: 100’ x 72’ Site Area: 7,200 sft Area FAR: 4.1 Plot FAR: 3.75 Applicable FAR: 3.75 Total Build Up Area = 7,200 x 3.75 = 27,000 sft Lobby, Lift, Stair Area = 300 sft (apprx.) Total Floor Area = 27,000 - 300 sft = 26,700 sft Residential Unit Area = 26,700/13 sft (if the residence in G+13) = 2,053.846 sft MGC = 57.5% x 72,000 = 4,140 sft Open space = 7,200 – 4,140 sft = 3,060 sft Soak able space = 50% x 3,060 sft = 1,530 sft Proposed Site
  • 23.
    2024 2018 2013 20102008 2004 Evolution of the Site
  • 24.
    Survey Photography Piling Goingon Site Current Situation of Site Front of The Site Sign Board of Construction 25’ Wide Road on Site 40’ Wide Road on Site Traffic in Front of School To Let Sign of Apartments Road Under Maintenance Boys Playing in Empty Plot
  • 25.
    S.W.O.T ANALYSIS STRENGTH WEAKNESESSOPPORTUNITY THREATS The related plot is in full residential environment and near two educational institute. Traffic rush at school time, more traffic and populated in roads. More facilities likes (gym, pool, day care, well being) can be provided in Apartments. South face is blocked by the near apartments building so the south ventilation and day light may interrupt. Site is faced towards North and East site is also preferable. Lack of recreational facilities and public amenities and market, shops are quite away. Large, luxurious and comfortable apartments can be designed. Lack of public amenities or facilities in apartment may lead to less rent price or unsold of flats. Well access & connectivity. The site is surrounded by two active roads. One is 25’ Wide road, another is 40’ wide road. Building height restrictions for the air funneling zone (OLS). Heights limited to 150’. School and Mosque is near the site, so it is a good chance to rent or sell the flats easily. Roads are under maintenance all time, so the residents may facing the difficulty of access. More secured area and well developed residential area, best for any type of apartments or housing. Monotonous apartments and buildings arrangement and height. Public facilities or amenities can be served for other residents as well. No public transport, only rickshaws and private vehicles. This will lost interest to buy flats here and house rent.
  • 26.
  • 27.
    Findings from theSurvey Most of the developer companies builds 1800- 2200 sft apartments. Easily accessible from 300 ft road, 100 ft road & Progoti Shoroni. Shopping mall, Hospital and Educational Institutes are available within the range of 2 km. Lack of luxurios apartments in this area. Only a few condominiums are established in this residential area. Studio apartments/ Single unit can be a good chance. Very few apartments has basement parking, rest of ground floor parking. Buildings are mostly G+9 or G+5, heights from 60 ft to 110 ft. Most of family prefers small/medium apartments. Lack of playing or community space, this can be combined with apartments. Problem of parking, electricity, security and water. People likes the apartments which including green, services and energy efficient design. People not just wants to live also like to lead a healthy life. Basic apartments including 3 BHK or 2 BHK.

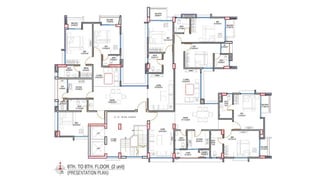

  • 28.

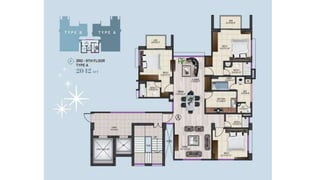

    • Project Name:Modhumita Villa. • Project Address: Plot-746, Block-I, Road No-10, Bashundhara R/A, Dhaka. • Land Area: 10 Katha. • Floors: Ground +9 (10 Storied). • Bedroom: 4 nos. • Parking: 18 Parking Spaces. • Lift & Stair: 2 Lift and 1 Stair. • Building Facing: North Faced. • Apartment Size: 2200 sft & 2050 sft. • Current Situation: Under Construction. Project in this Site
  • 30.
  • 31.

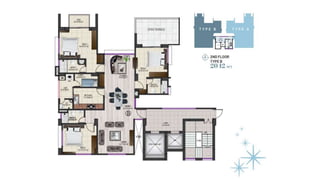

  • 32.
    • Project Name:DDPL Mukter Mansion • Project Address: Plot-1256, Block-1, Road No-20, Bashundhara R/A • Land Area: 5 Katha • Number of Stories: Ground + 8 (9 Storied) • Apartment Size: 2100 sft. • No of Apartment: 8 Nos. • Building Face: North facing. • Floor Distribution: Ground Floor, 8 Car Parking, Sub station & Generator Room, Guard Room, Waiting Room, 1st to 8th Floor Apartment. • Apartment Consists: 4 Bed room, 5 Toilet, Living, 4 Veranda, Kitchen, Drawing & Dining area. • Project Start: February, 2023 • Project Handover: June, 2025

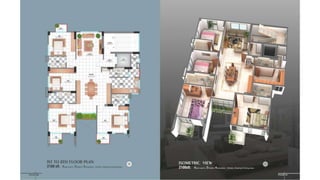

  • 34.

    • Project Name:Sheltech ELENA. • Project Address: Plot # 353, Road # 10, Block # C, Basundhara R/A, Dhaka. • Type: 9 storied, (G+7) Residential building. • Land Area: 7.50 katha. • Road: 25'-0" (South). • Total no. of units: 14. • No. of Parking: 14. • Building Face: South facing • Unit type: Type A (+1800 sft.) Type B (+1800 sft.) • No. of Lifts: 01. • No. of Staircases: 01, with fire door. • Project Status: Construction Running.

  • 36.

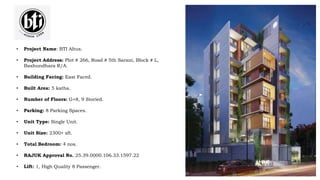

    • Project Name:BTI Altus. • Project Address: Plot # 266, Road # 5th Sarani, Block # L, Bashundhara R/A. • Building Facing: East Faced. • Built Area: 5 katha. • Number of Floors: G+8, 9 Storied. • Parking: 8 Parking Spaces. • Unit Type: Single Unit. • Unit Size: 2300+ sft. • Total Bedroom: 4 nos. • RAJUK Approval No. 25.39.0000.106.33.1597.22 • Lift: 1, High Quality 8 Passenger.
  • 40.

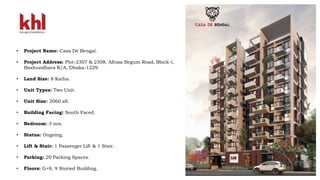

    • Project Name:Casa De Bengal. • Project Address: Plot-2307 & 2308, Afroza Begum Road, Block-l, Bashundhara R/A, Dhaka-1229. • Land Size: 8 Katha. • Unit Types: Two Unit. • Unit Size: 2060 sft. • Building Facing: South Faced. • Bedroom: 3 nos. • Status: Ongoing. • Lift & Stair: 1 Passenger Lift & 1 Stair. • Parking: 20 Parking Spaces. • Floors: G+8, 9 Storied Building.
  • 45.

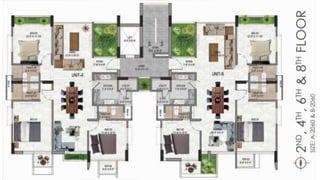

    • Project Name:BTI Sparkle • Project Address: Block-K, Bashundhara R/A, Dhaka. • Floors: G+9, 1o Storied. • Unit Types: Two Unit. • Unit Size: 2042 sft. • Building Facing: South Faced. • Bedroom: 3 nos. • Built Area: 10 Katha. • Lift: 1 Passenger & 1 Stretcher Lift. • Parking: 20 Parking Spaces. • RAJUK Approval No: 25.39.0000.106.33.276.21.
  • 52.
    R E FE R E N C E • Bashundhara Housing • Google Maps • BTI • Sheltech • Imagine Properties • Rehab BD • Rajuk • Anwar Land Mark • Wikipedia • Assure Group • Red Bricks Bd • The Business Standard • Dhaka Tribune • KHL T H A N K Y O U
