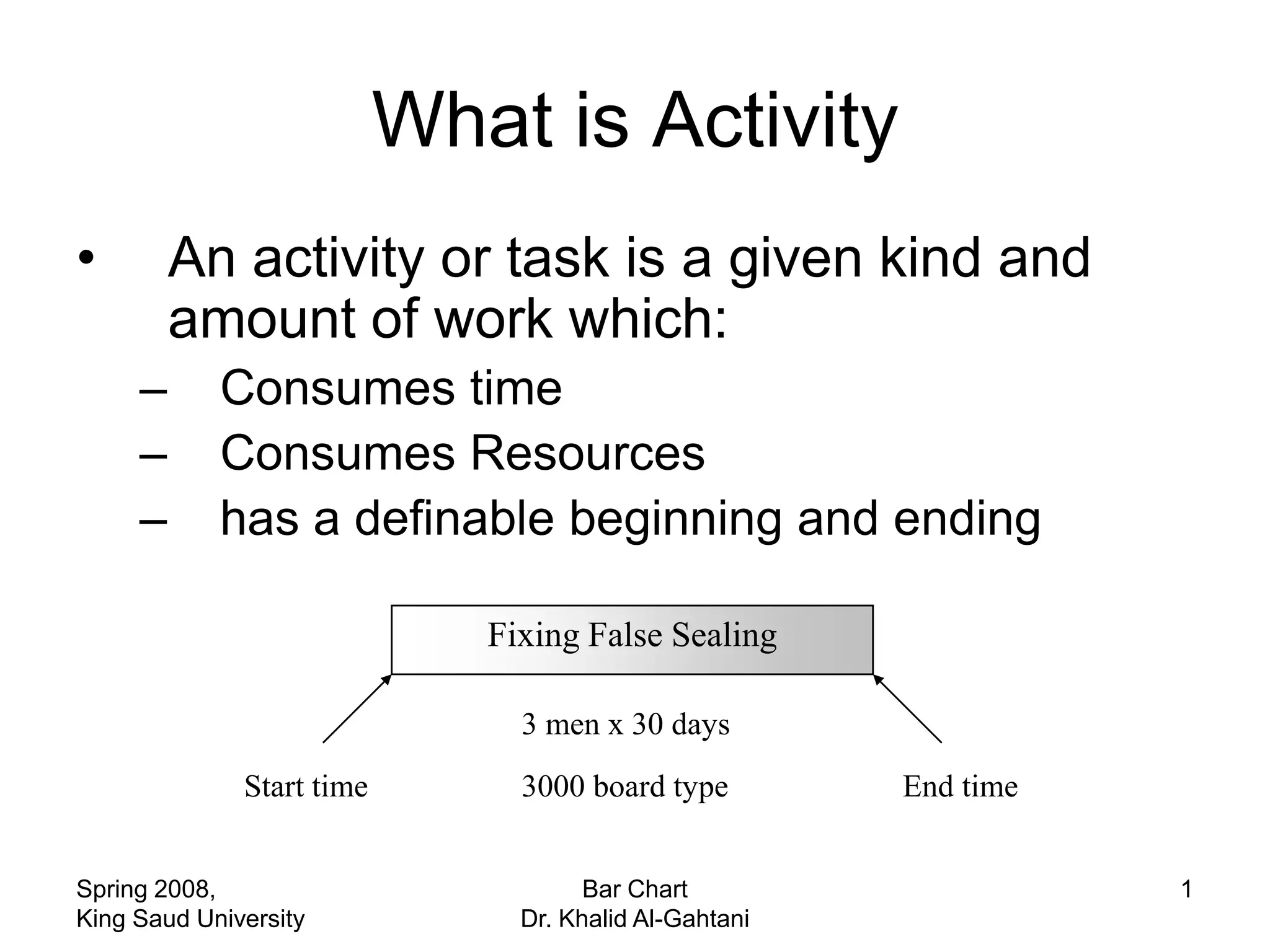

What is Activity
•        An activity or task is a given kind and
         amount of work which:
     –      Consumes time
     –      Consumes Resources
     –      has a definable beginning and ending

                              Fixing False Sealing

                                3 men x 30 days
              Start time        3000 board type         End time

Spring 2008,                          Bar Chart                    1
King Saud University            Dr. Khalid Al-Gahtani
What is Project
•        A project is a set of activities with
     –        A well-defined objective(s)
     –        A target completion date
     –        An estimated budget

                 Plan s &                                R equired
               Specification s                           Product
                                    Project
                                 M an agem ent

                  L im ited                                Project
     G iven      R esources                              O bjectives   D esired

Spring 2008,                           Bar Chart                                  2
King Saud University             Dr. Khalid Al-Gahtani
Type of Schedule
•        Written Schedule
•        Gantt Chart (Bar Chart)
•        CPM Schedules (Critical Path Method)
                                                            A
     –      Activity on Arrow                               5
     –      Activity on Node AB                         A       B

•        PERT
                        30   X = 36     40

•        LSM (Linear Schedule Method)
Spring 2008,                          Bar Chart                     3
King Saud University            Dr. Khalid Al-Gahtani
Bar Chart
•        STEPS
     –         Analyze the project and specify the basic approach
               to be used.
     –         Break the project down into a reasonable number of
               activities to be scheduled.
     –         Estimate the time required to perform each activity.
     –         Place the activities in sequence of time, taking into
               account the requirements that certain activities
               must be performed sequentially.
           •     Logical constrain
           •     Resources constrain
     –         If a completion date is specified, the diagram is
               adjusted until this constraint is satisfied.

Spring 2008,                         Bar Chart                     4
King Saud University           Dr. Khalid Al-Gahtani
Bar Chart
• Example:
       Activity Activity Description Dependency Duration
         ID
          A         Excavation                     3
            C              Foundation                     A     3
            D               Column                       B, C   2
            B          Moving the soil out                A     2
            E                 Wall                       C, D   5
            F                 Roof                       E, D   5
Spring 2008,                           Bar Chart                    5
King Saud University             Dr. Khalid Al-Gahtani

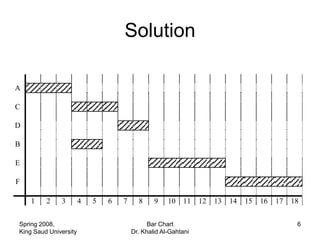

Solution

A

C

D

B

E

F

    1    2    3        4   5   6   7     8     9    10   11    12   13   14   15   16   17   18

Spring 2008,                                 Bar Chart                                        6
King Saud University                   Dr. Khalid Al-Gahtani

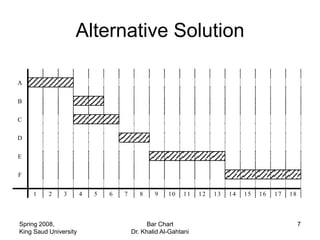

Alternative Solution

A

B

C

D

E

F

    1     2    3       4   5   6   7      8    9    10    11   12   13   14   15   16   17   18

Spring 2008,                                 Bar Chart                                            7
King Saud University                   Dr. Khalid Al-Gahtani

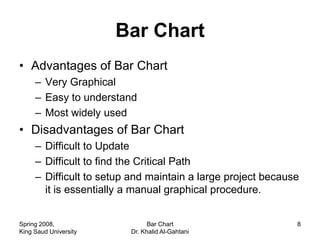

Bar Chart
• Advantages of Bar Chart
     – Very Graphical
     – Easy to understand
     – Most widely used
• Disadvantages of Bar Chart
     – Difficult to Update
     – Difficult to find the Critical Path
     – Difficult to setup and maintain a large project because
       it is essentially a manual graphical procedure.

Spring 2008,                   Bar Chart                     8
King Saud University     Dr. Khalid Al-Gahtani

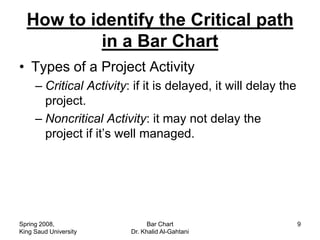

How to identify the Critical path
           in a Bar Chart
• Types of a Project Activity
     – Critical Activity: if it is delayed, it will delay the
       project.
     – Noncritical Activity: it may not delay the
       project if it’s well managed.

Spring 2008,                   Bar Chart                        9
King Saud University     Dr. Khalid Al-Gahtani
STEPS to identify the Critical Path

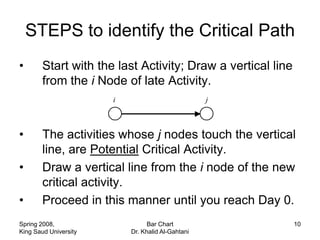

•       Start with the last Activity; Draw a vertical line
        from the i Node of late Activity.
                       i                           j

•       The activities whose j nodes touch the vertical
        line, are Potential Critical Activity.
•       Draw a vertical line from the i node of the new
        critical activity.
•       Proceed in this manner until you reach Day 0.
Spring 2008,                     Bar Chart                   10
King Saud University       Dr. Khalid Al-Gahtani

Identify the Critical Path

A

B

C

D

E

F

    1    2     3       4   5   6   7      8     9    10   11   12   13   14   15   16   17   18
Spring 2008,                                 Bar Chart                                       11
King Saud University                   Dr. Khalid Al-Gahtani
Class Work
        Activity       Depends upon                Duration (Weeks)
          A                C, J                            3
           B                F                              2
           C                F                              3
          D                C, I                            4
           E                G                              5
           F                H                              4
          G                 H                              2
          H                 -                              3
           I               E, F                            4
           J                B                              2
Spring 2008,                     Bar Chart                            12
King Saud University       Dr. Khalid Al-Gahtani
CW Solution
Act. W1 W2 W3 W4 W5 W6 W7 W8 W9 W10 W11 W12 W13 W14 W15 W16 W17 W18
 H
 F
 G
 E
 I
 B
 C
 J
 A
 D

Spring 2008,                    Bar Chart                        13
