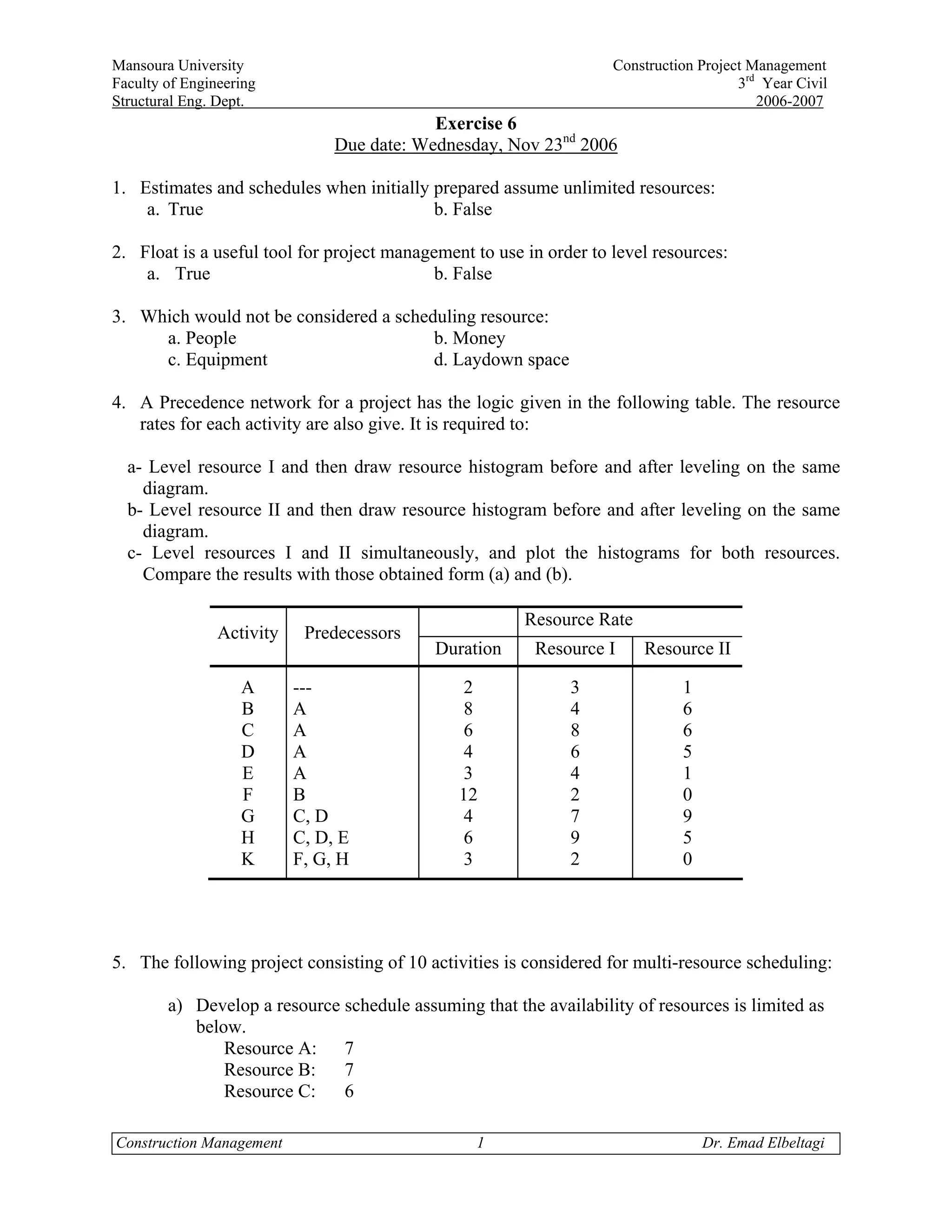

This document contains information and questions related to construction project management. It includes examples of precedence networks, resource requirements for activities, and questions about scheduling and leveling resources for multiple construction projects. Students are asked to develop resource schedules and histograms that satisfy limited resource availability and project duration constraints.
