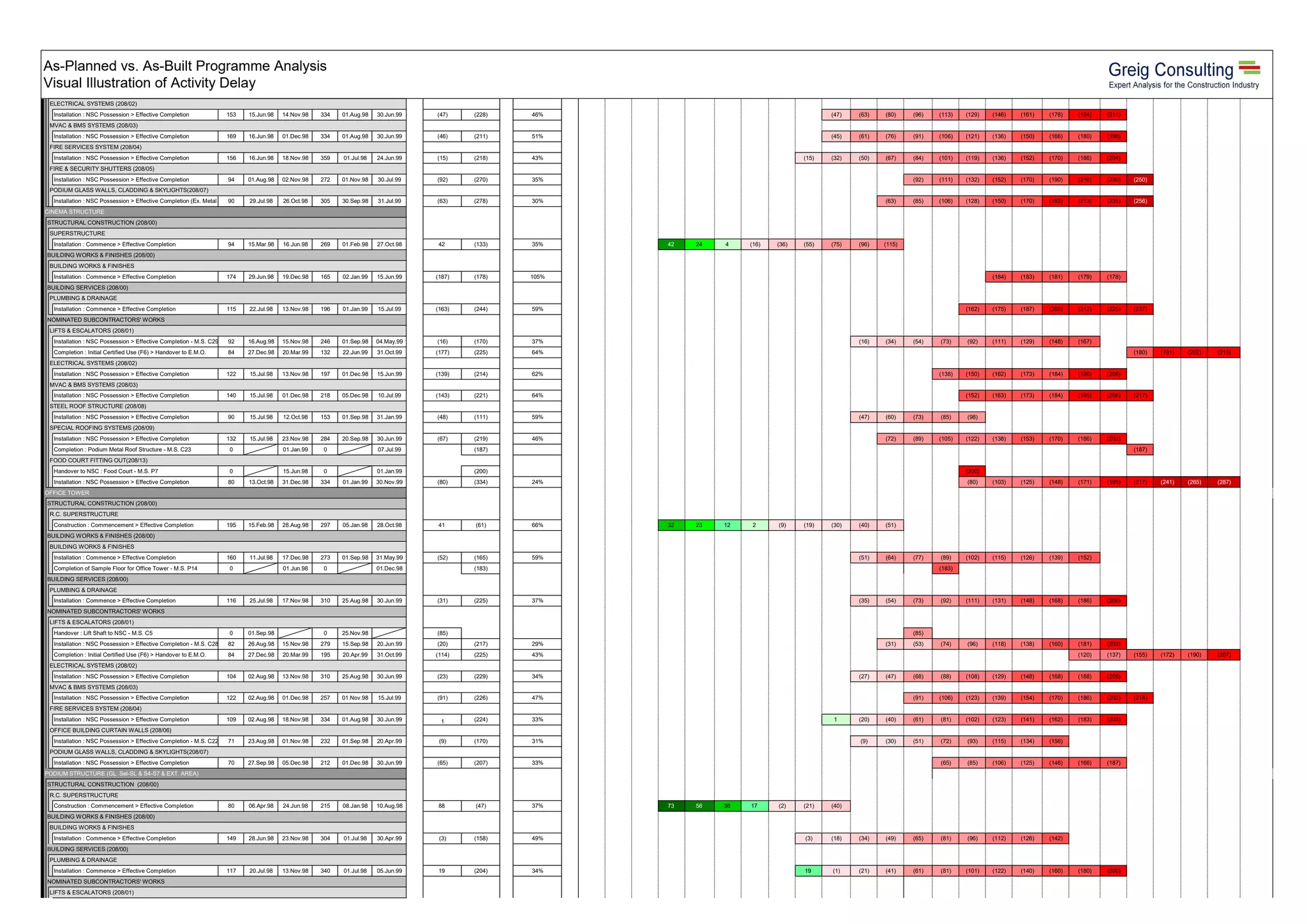

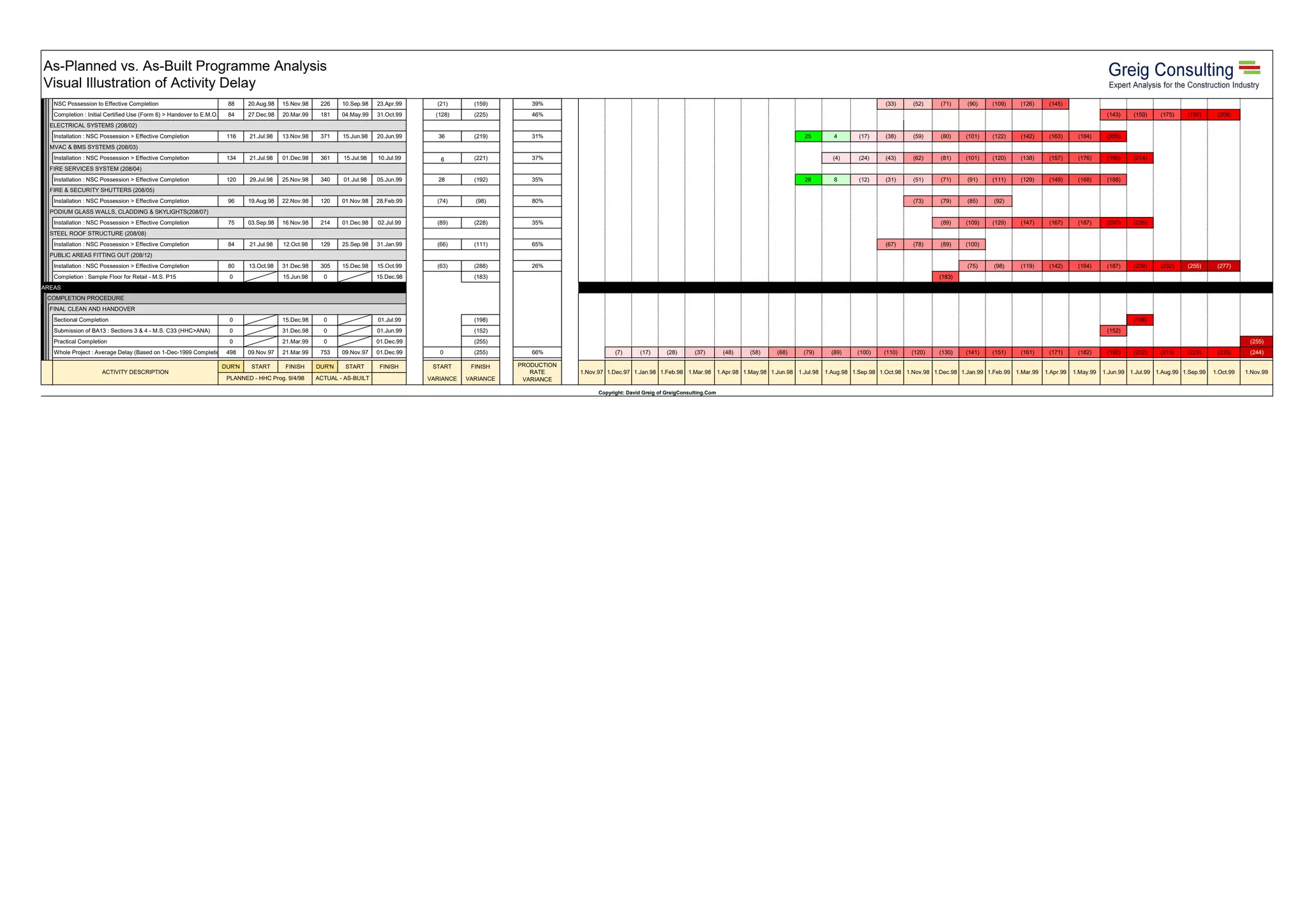

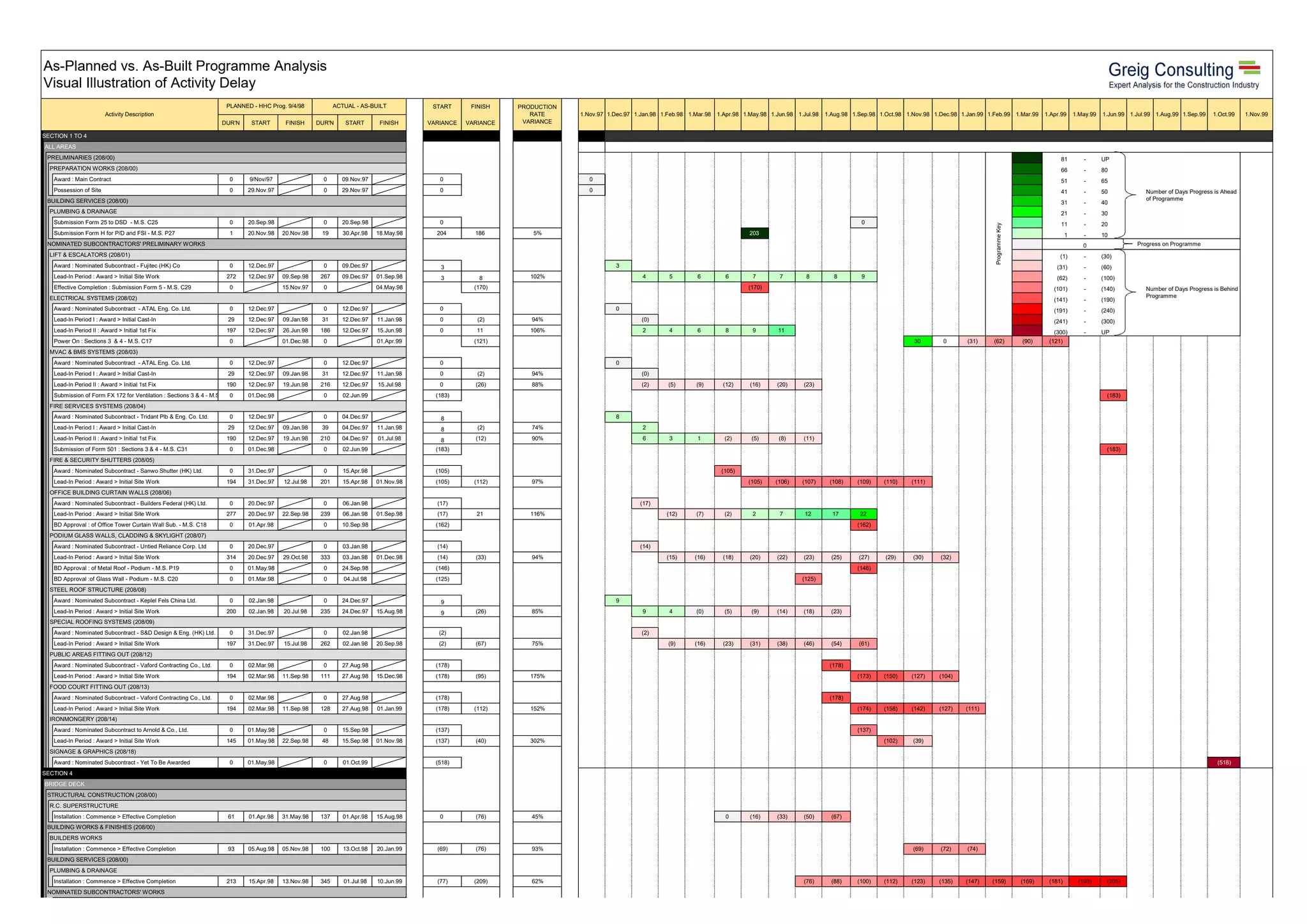

This document provides a timeline and status of various construction projects and subcontracted works for a development. It includes start and finish dates for sections, award dates for subcontracts, and visual comparisons of planned versus actual progress. Most areas were behind schedule, with electrical, HVAC, and roofing systems experiencing the largest delays over 200 days.
