1Copyright © 2014, Innolution, LLC. All Rights Reserved.
Agile IS Risk Management
Agile 2014
Orlando, FL
July 29, 2014
by Ken Rubin
2Copyright © 2007-2014, Innolution, LLC. All Rights Reserved.
Background of Ken RubinAuthorTrainer
Coach
Exp
Trained more than
20,000 people
Coach developers
and executives
1st Managing
Director
1st Scrum project
was in 2000 for
bioinformatics
3Copyright © 2014, Innolution, LLC. All Rights Reserved.
Agenda
Uncertain Events
Managing Risk via the
Product Backlog
Maximize Expected
Monetary Value
Using Agile to Avoid
Some Uncertain
Situations
Traditional Risk
Management
Agile Principle-based
Risk Management
4
Some questions… and discussion…
Copyright © 2014, Innolution, LLC. All Rights Reserved.
We outsource stress-testing of our application to a third-
party and there is a risk it won’t be done when
promised. How do we handle this?
How do we manage the risks of a fixed-price contract?
Should we try to avoid the risk of building the wrong
product by working longer and harder up front to get its
specification right?
We lack knowledge to make an informed technical
choice. So there is a risk of a bad decision. How should
we proceed?
5

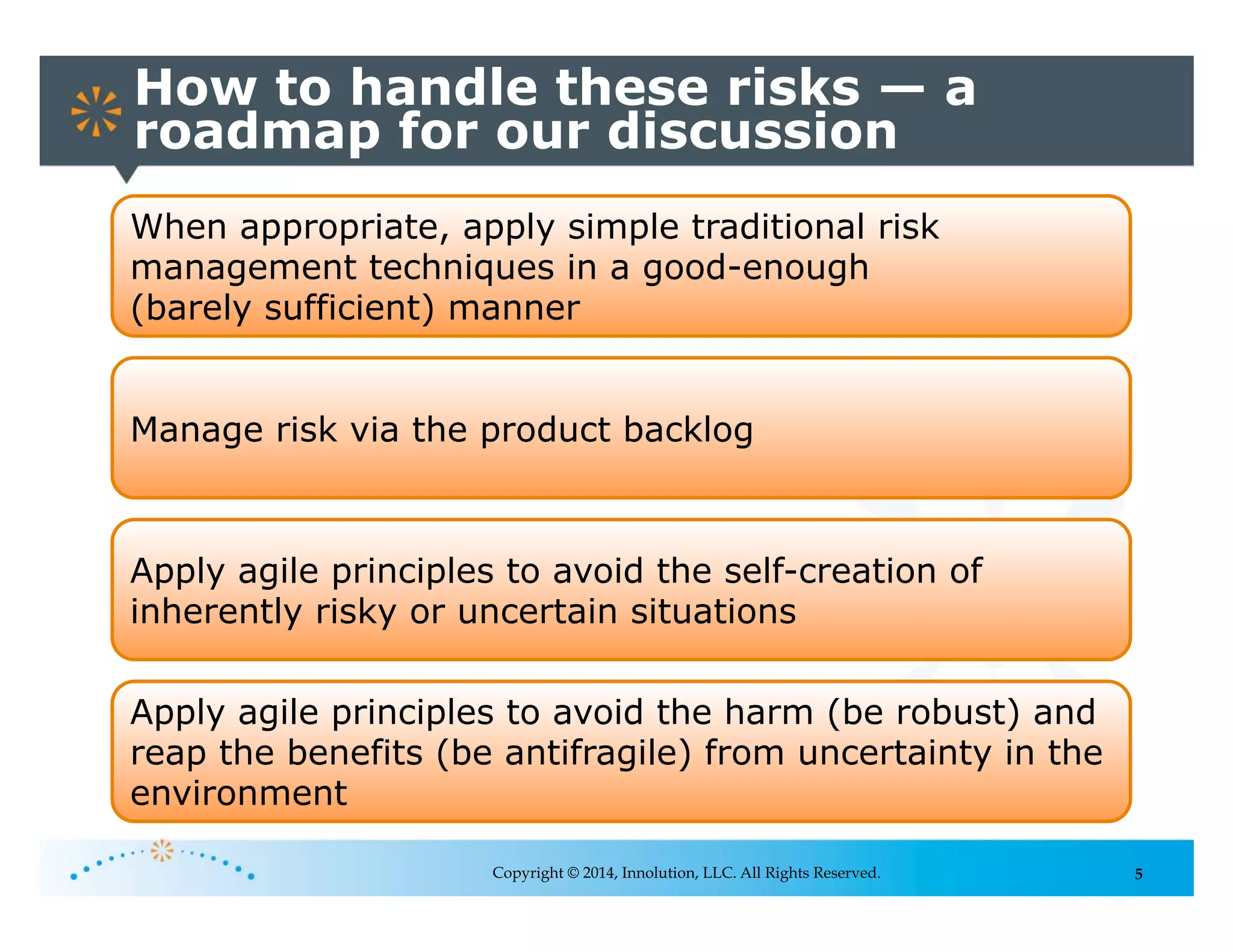

How to handle these risks — a
roadmap for our discussion
Copyright © 2014, Innolution, LLC. All Rights Reserved.
When appropriate, apply simple traditional risk
management techniques in a good-enough
(barely sufficient) manner
Apply agile principles to avoid the self-creation of
inherently risky or uncertain situations
Apply agile principles to avoid the harm (be robust) and
reap the benefits (be antifragile) from uncertainty in the
environment
Manage risk via the product backlog
6Copyright © 2014, Innolution, LLC. All Rights Reserved.
Uncertain Events
7

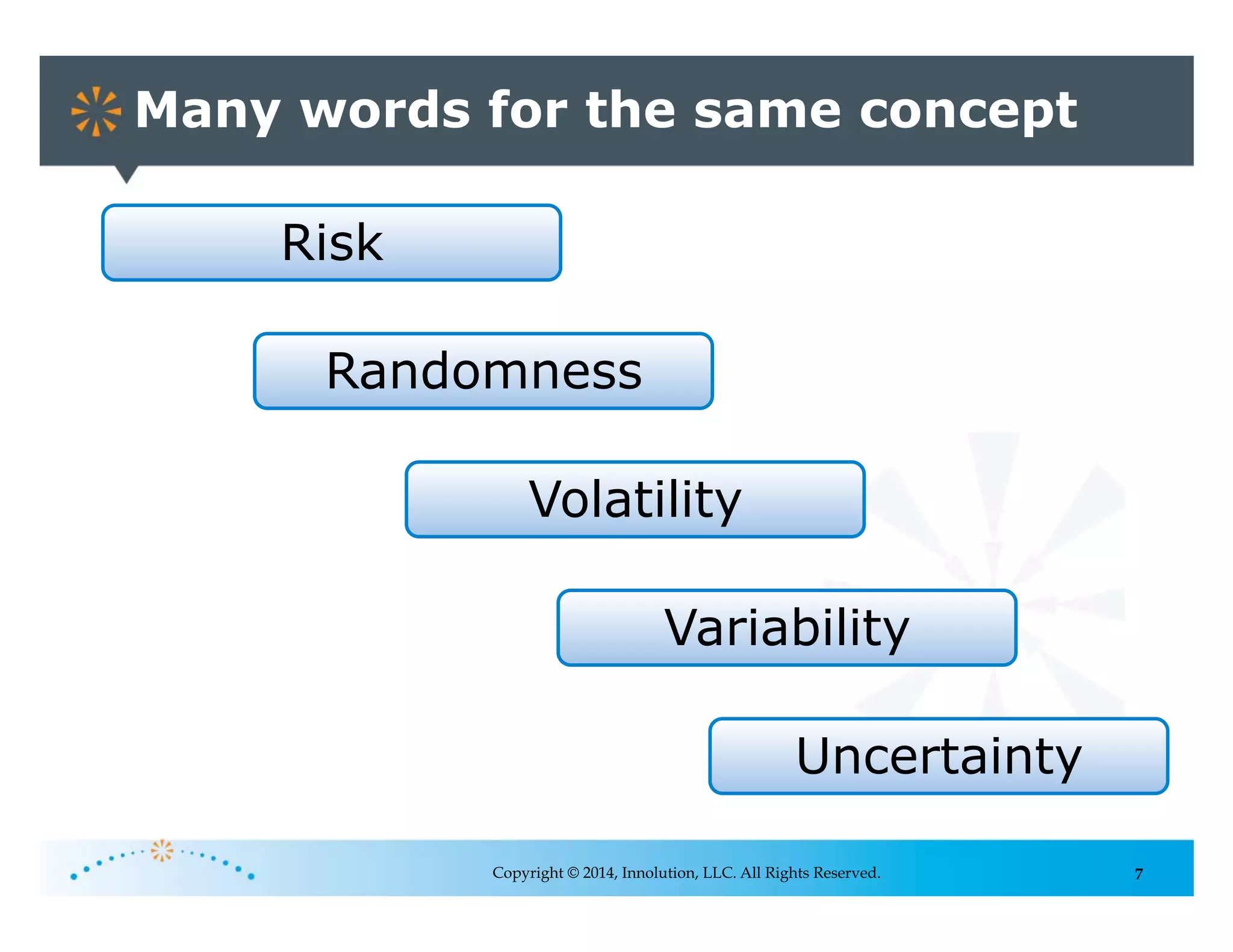

Many words for the same concept
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Risk
Randomness
Volatility
Variability
Uncertainty
8
For our purposes we will treat
them the same
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Lack of knowledge regarding
uncertain events
9

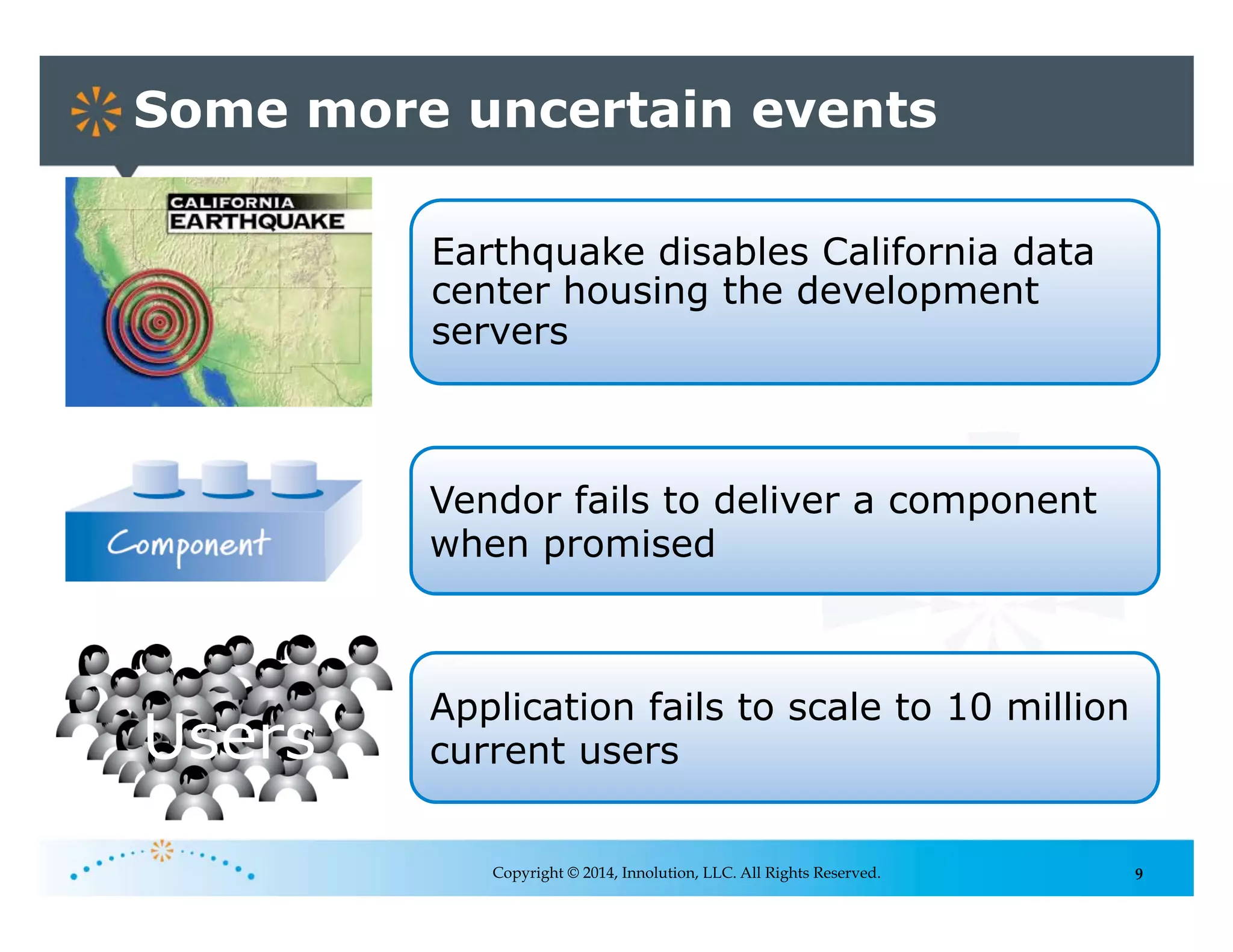

Some more uncertain events
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Earthquake disables California data
center housing the development
servers
Vendor fails to deliver a component
when promised
Application fails to scale to 10 million
current usersUsers
10Copyright © 2014, Innolution, LLC. All Rights Reserved.

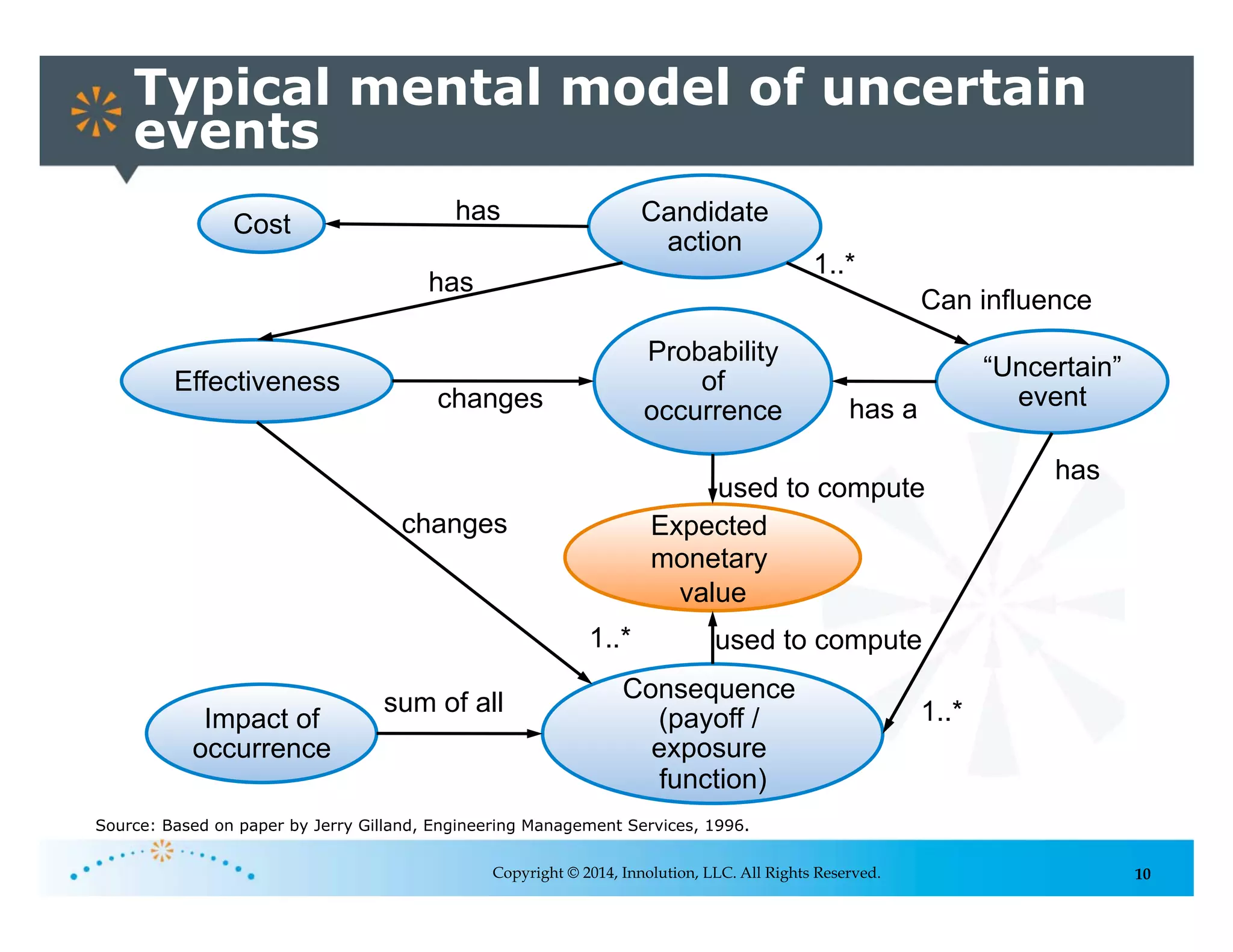

Typical mental model of uncertain
events
“Uncertain”
event
Probability
of
occurrence
Consequence
(payoff /
exposure
function)
Impact of
occurrence
sum of all
has a
has
Cost Candidate
action
Effectiveness
has
has
changes
changes
1..*
Can influence
1..*
1..*
Expected
monetary
value
used to compute
used to compute
Source: Based on paper by Jerry Gilland, Engineering Management Services, 1996.
11Copyright © 2014, Innolution, LLC. All Rights Reserved.
Maximize Expected
Monetary Value
12

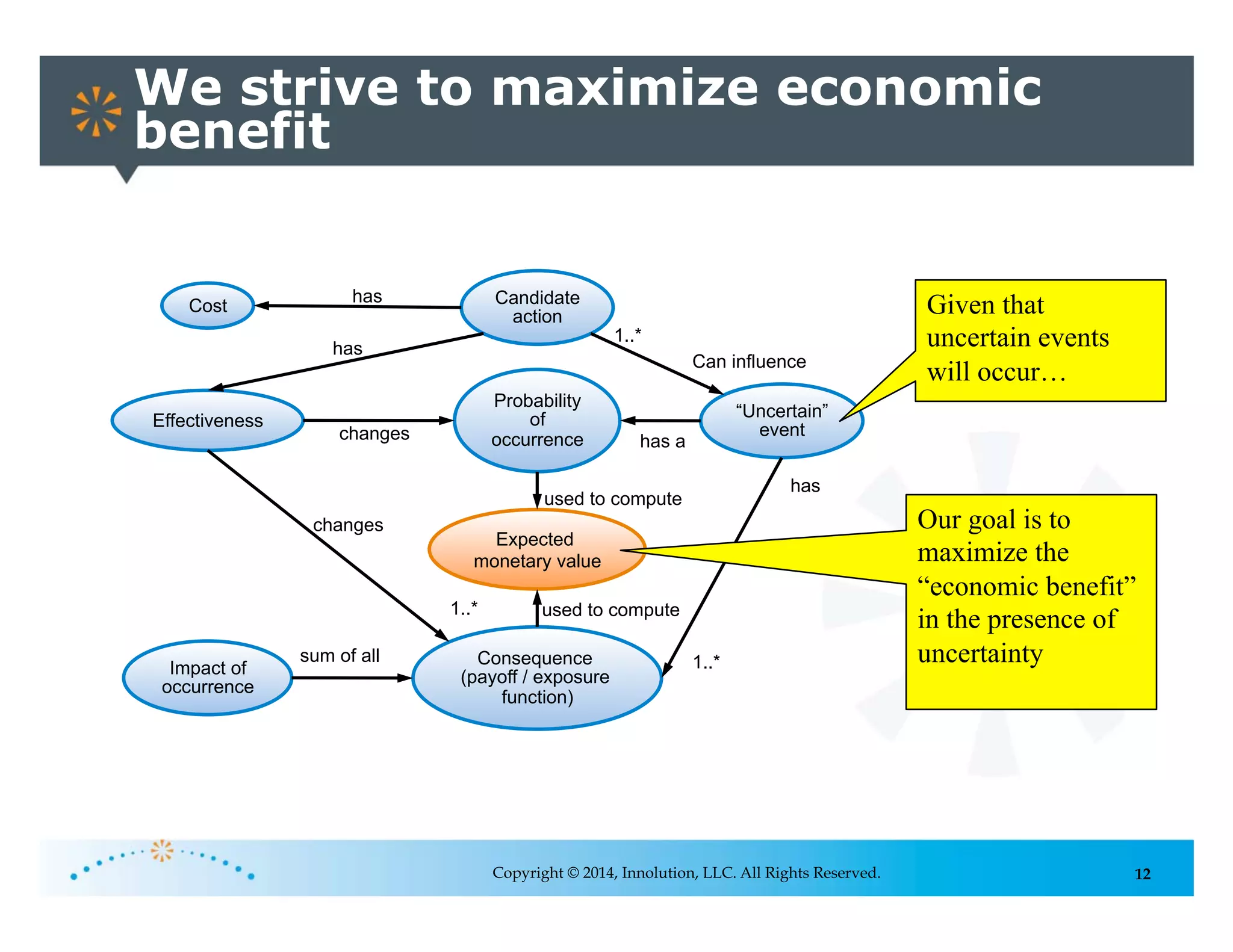

We strive to maximize economic
benefit
Copyright © 2014, Innolution, LLC. All Rights Reserved.
“Uncertain”
event
Probability
of
occurrence
Consequence
(payoff / exposure
function)
Impact of
occurrence
sum of all
has a
has
Cost Candidate
action
Effectiveness
has
has
changes
changes
1..*
Can influence
1..*
1..*
Expected
monetary value
used to compute
used to compute
Our goal is to
maximize the
“economic benefit”
in the presence of
uncertainty
Given that
uncertain events
will occur…
13

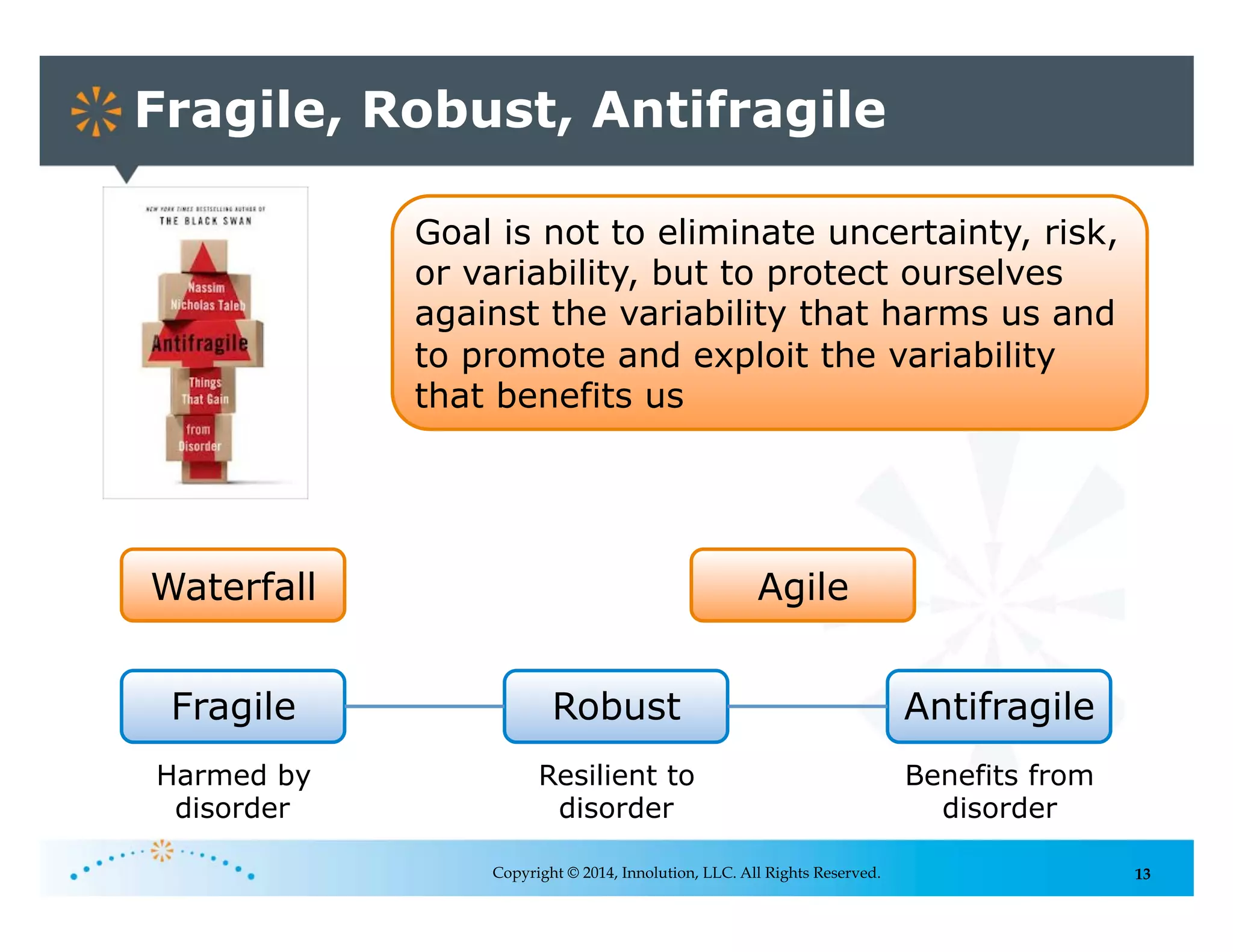

Fragile, Robust, Antifragile
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Fragile
Harmed by
disorder
Robust
Resilient to
disorder
Antifragile
Benefits from
disorder
Agile
Goal is not to eliminate uncertainty, risk,
or variability, but to protect ourselves
against the variability that harms us and
to promote and exploit the variability
that benefits us
Waterfall
14

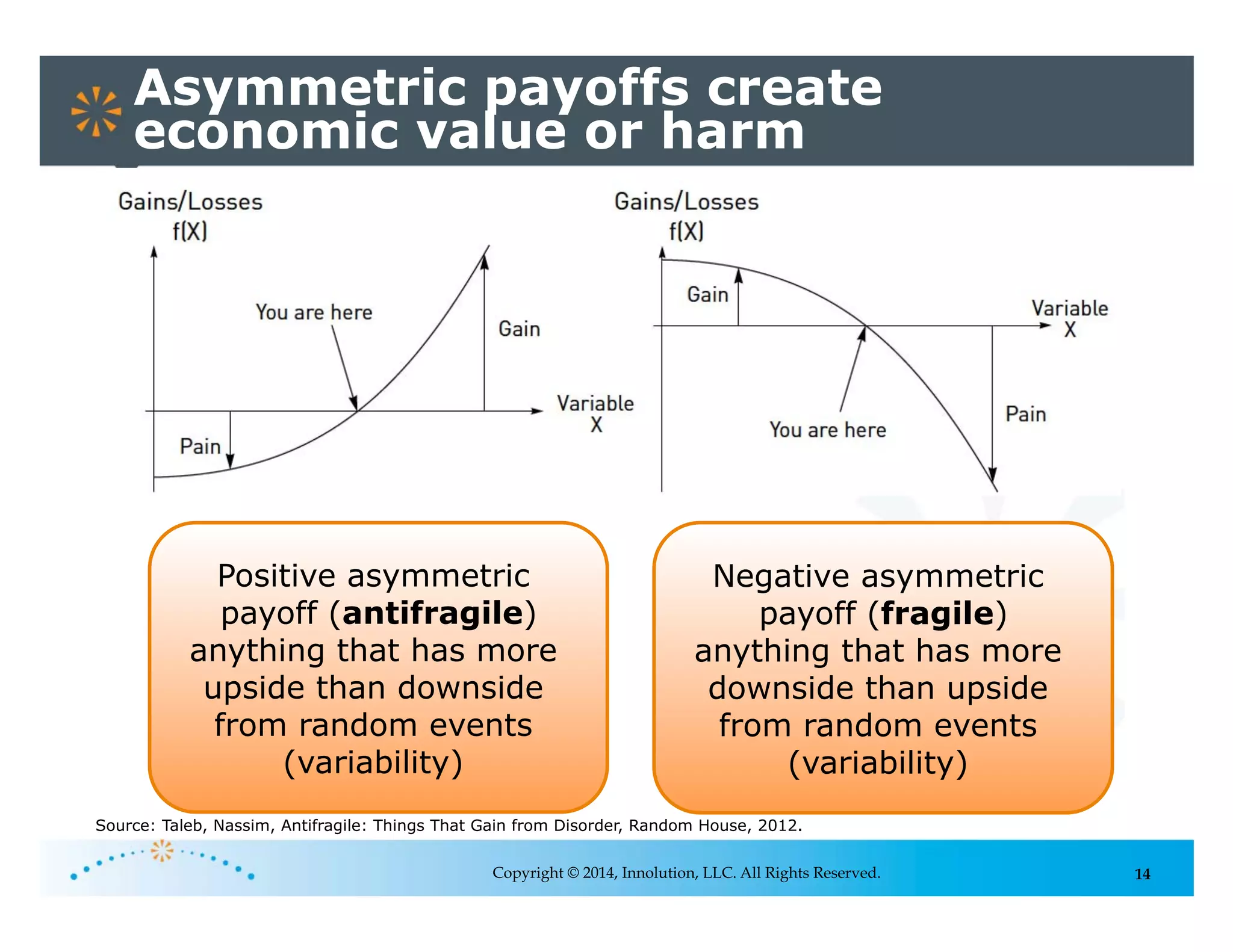

Asymmetric payoffs create
economic value or harm
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Positive asymmetric
payoff (antifragile)
anything that has more
upside than downside
from random events
(variability)
Negative asymmetric
payoff (fragile)
anything that has more
downside than upside
from random events
(variability)
Source: Taleb, Nassim, Antifragile: Things That Gain from Disorder, Random House, 2012.
15Copyright © 2014, Innolution, LLC. All Rights Reserved.
Traditional Risk
Management
16

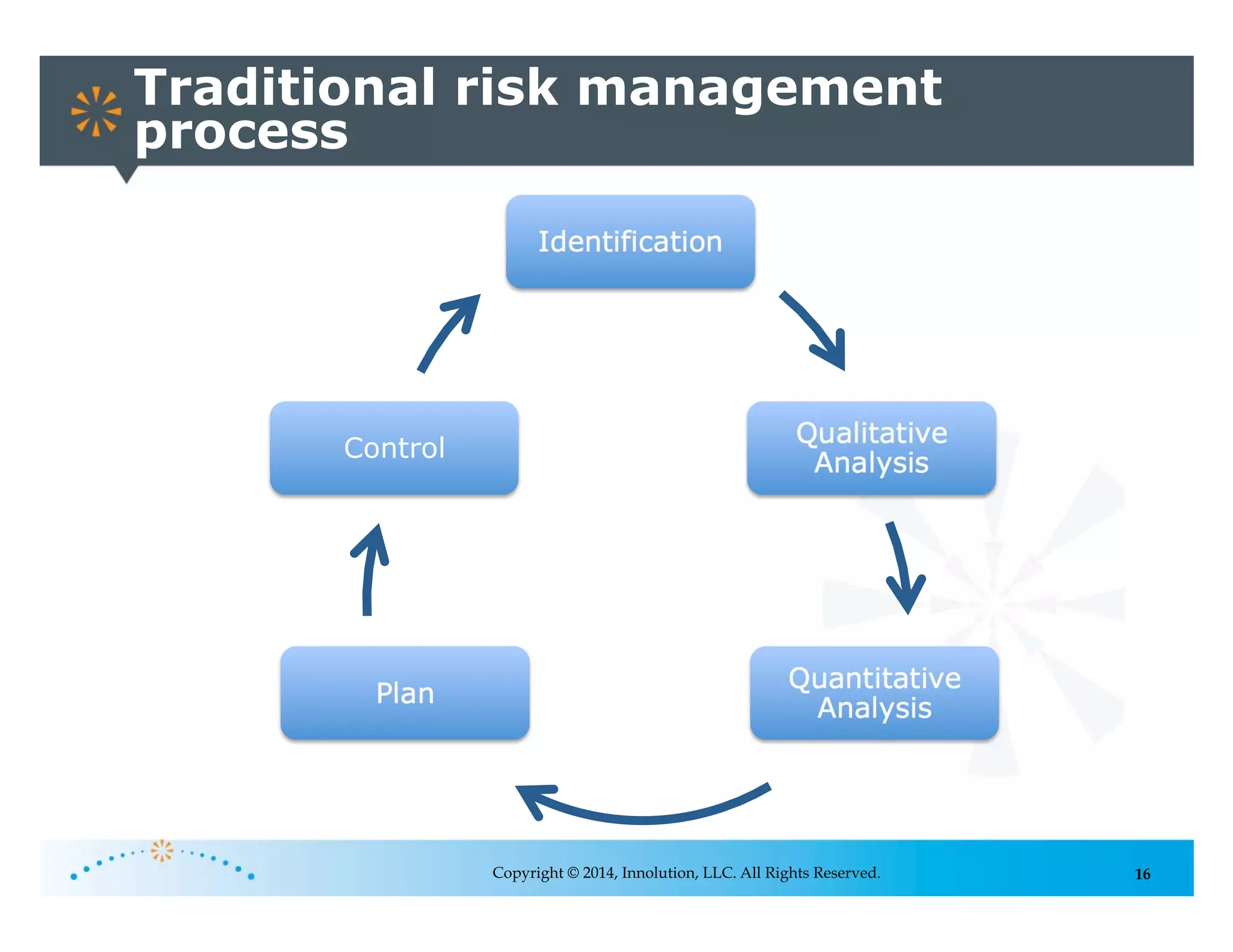

Traditional risk management
process
Identification
Qualitative
Analysis
Quantitative
Analysis
Plan
Control
Copyright © 2014, Innolution, LLC. All Rights Reserved.
17
Example traditional risk-
management artifacts
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Risk Prob Exposure Mitigation
0
20
40
60
80
100
0% 10% 20% 30% 40% 50%
Cost($K)
Probability %
1
2
3
4
5 6
7
8
9
10
Risk
Management
Plan
18

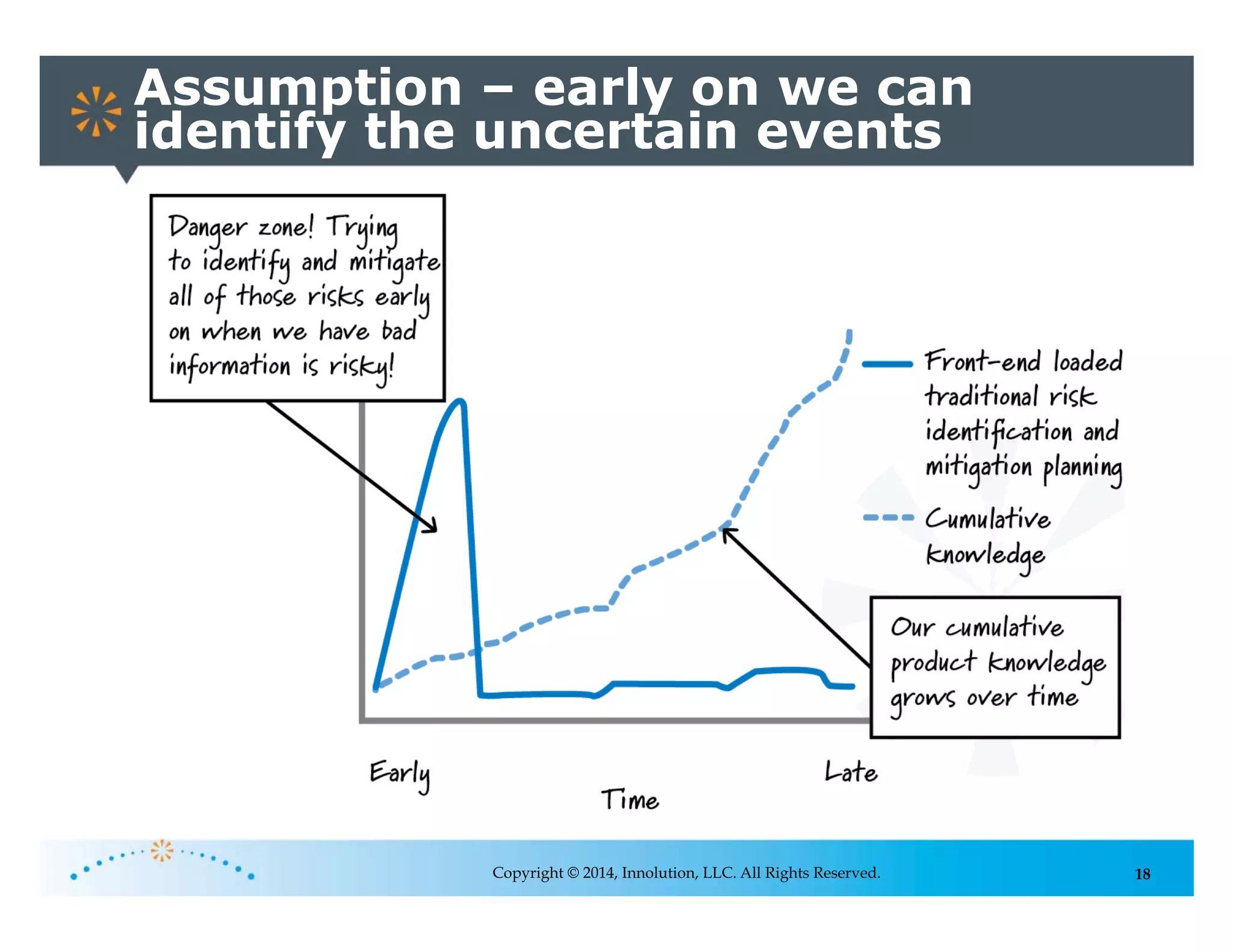

Assumption – early on we can
identify the uncertain events
Copyright © 2014, Innolution, LLC. All Rights Reserved.
19

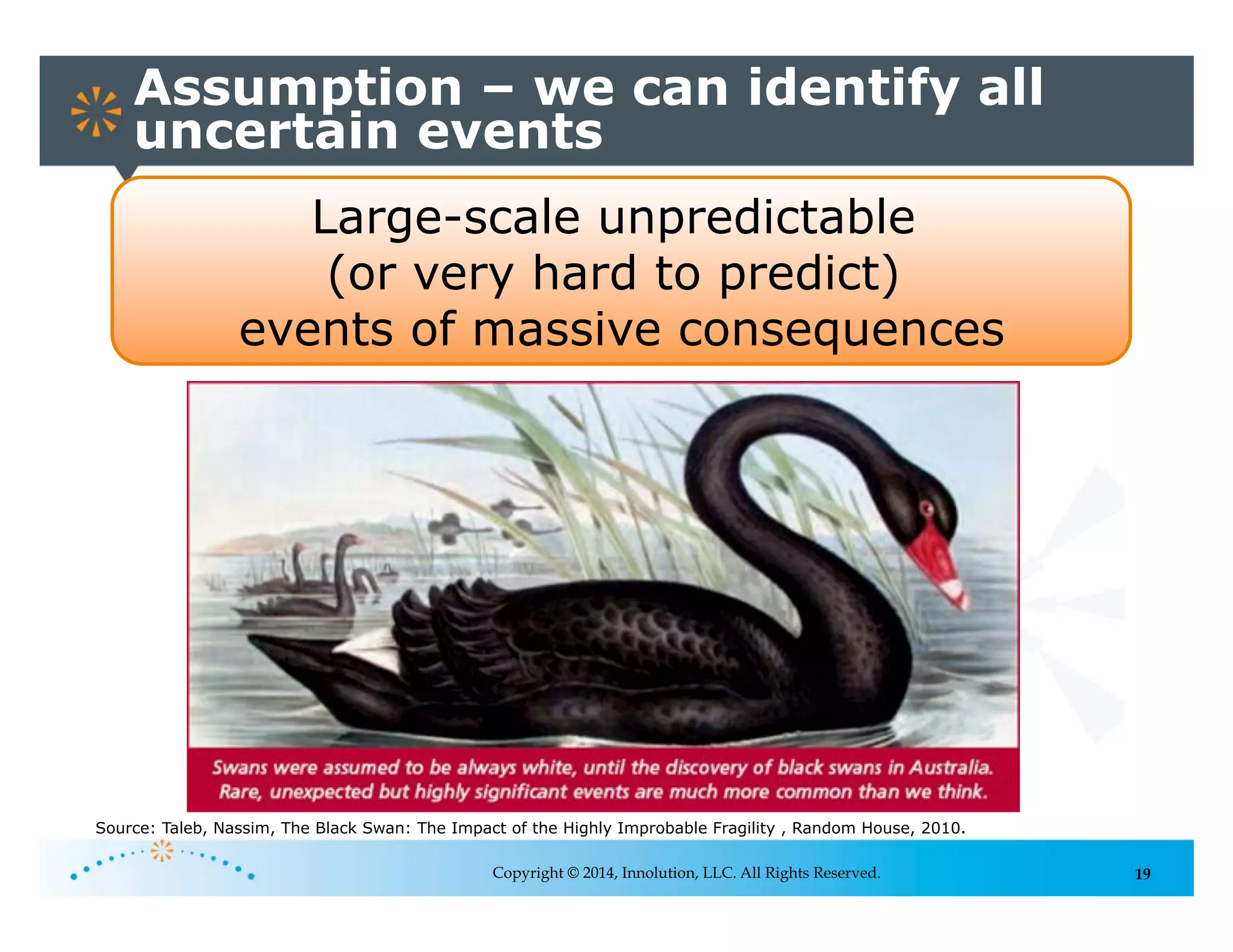

Assumption – we can identify all
uncertain events
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Large-scale unpredictable
(or very hard to predict)
events of massive consequences
Source: Taleb, Nassim, The Black Swan: The Impact of the Highly Improbable Fragility , Random House, 2010.
20Copyright © 2007-2014, Innolution, LLC. All Rights Reserved.

Assumption — we can accurately
calculate probabilities
0
20
40
60
80
100
0% 10% 20% 30% 40% 50%
Cost($K)
Probability %
1
2
3
4
5
6
7
8
9
10
Assumes we can predict the probabilities
21

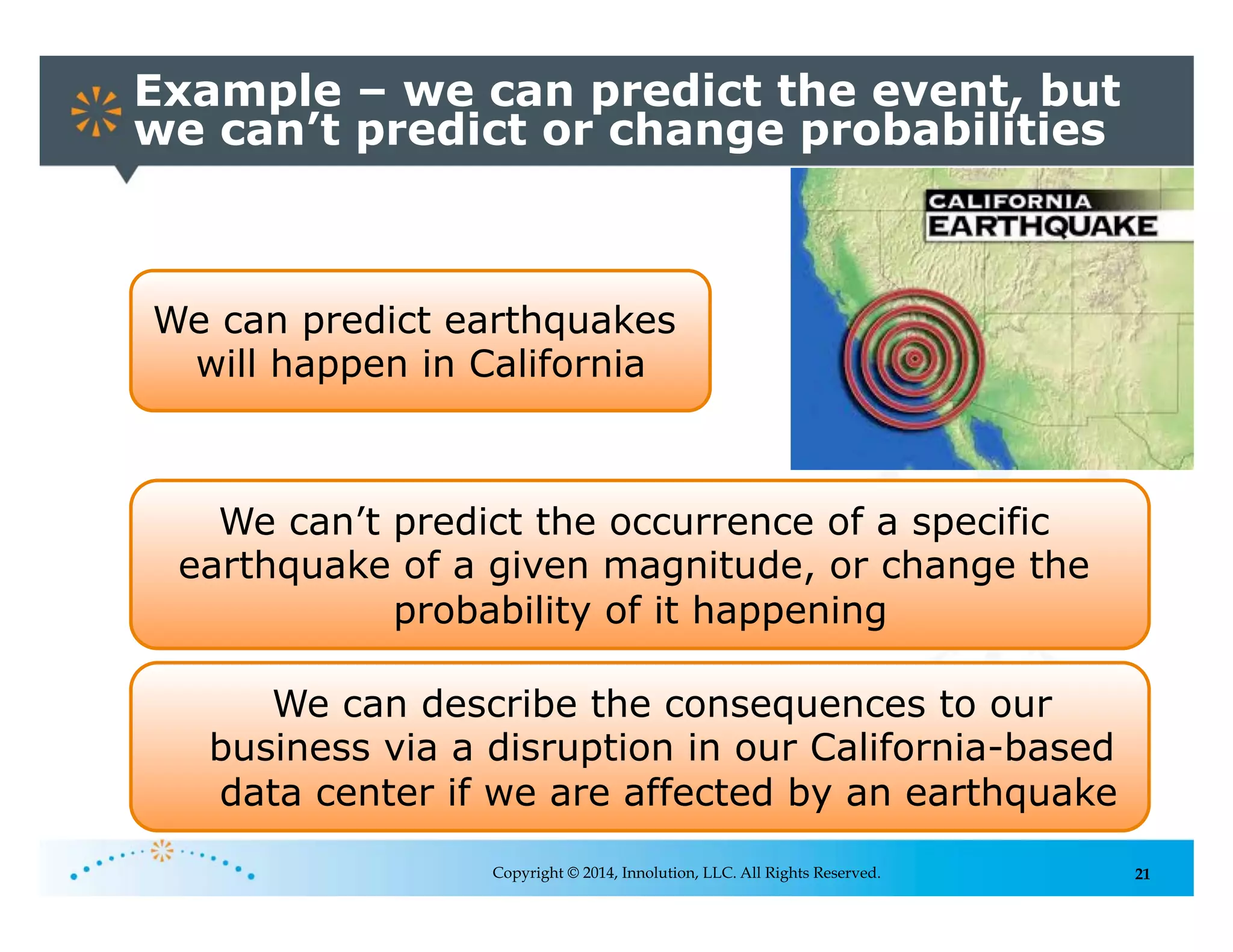

Example – we can predict the event, but
we can’t predict or change probabilities
Copyright © 2014, Innolution, LLC. All Rights Reserved.
We can predict earthquakes
will happen in California
We can’t predict the occurrence of a specific
earthquake of a given magnitude, or change the
probability of it happening
We can describe the consequences to our
business via a disruption in our California-based
data center if we are affected by an earthquake
22

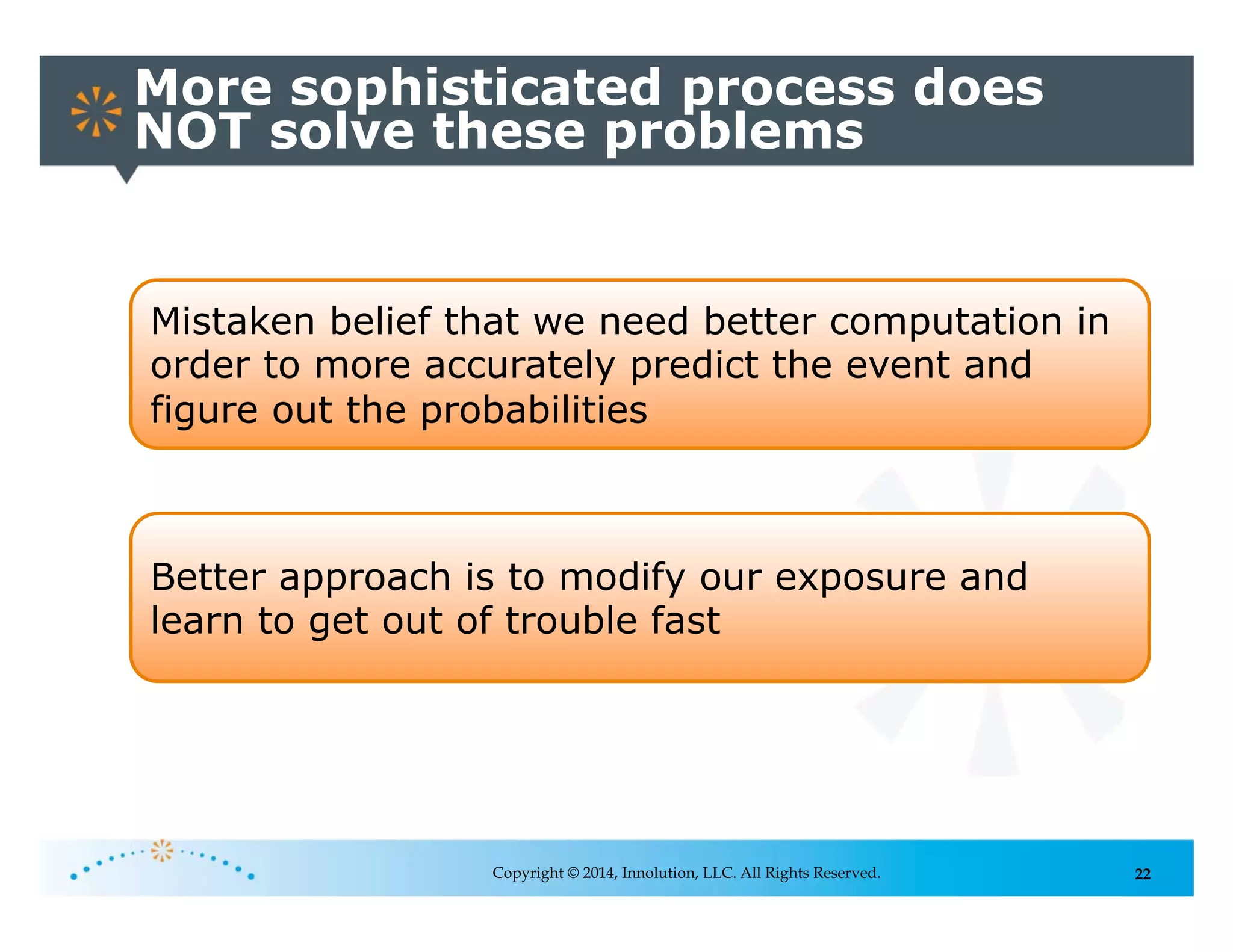

More sophisticated process does
NOT solve these problems
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Mistaken belief that we need better computation in
order to more accurately predict the event and
figure out the probabilities
Better approach is to modify our exposure and
learn to get out of trouble fast
23

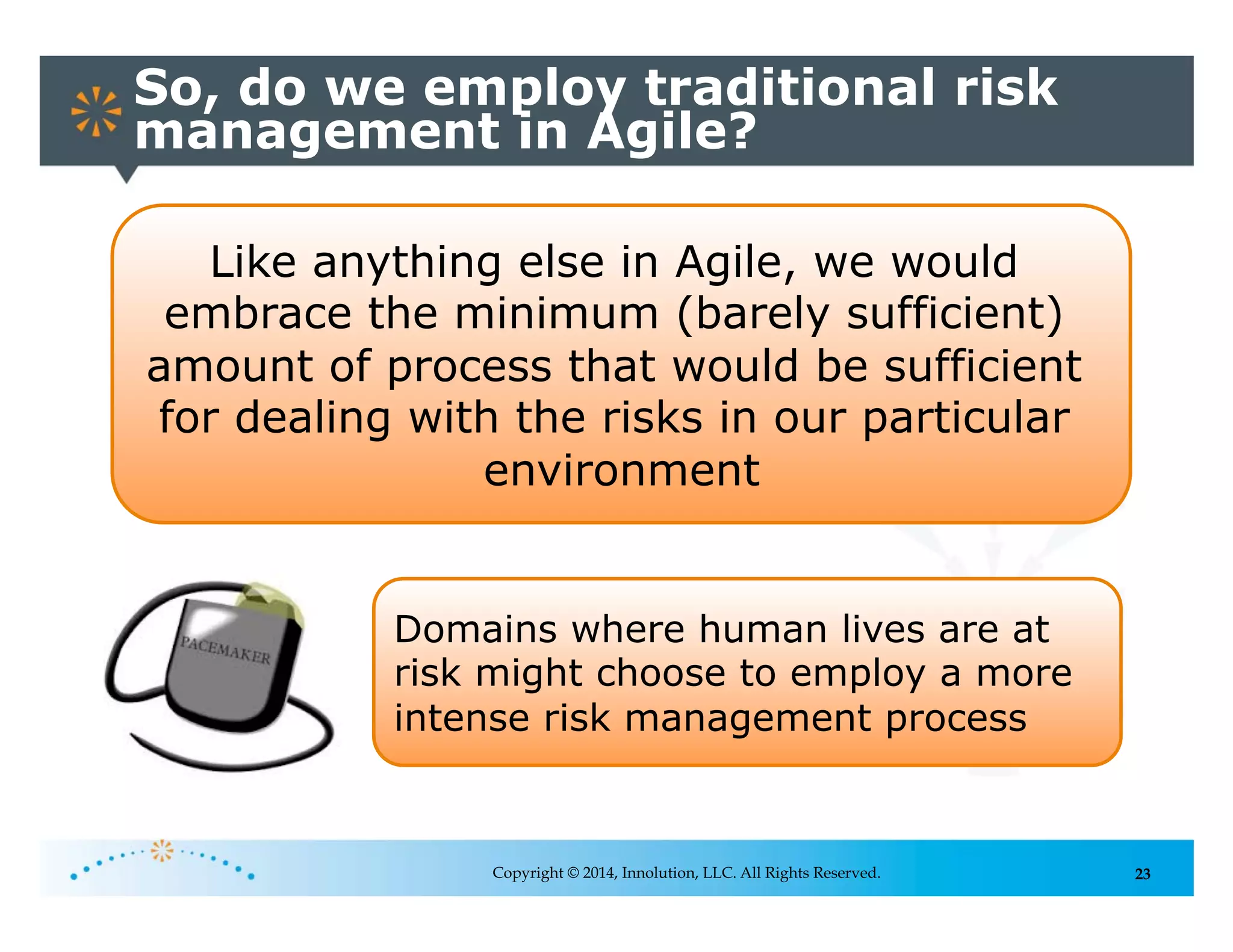

So, do we employ traditional risk
management in Agile?
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Like anything else in Agile, we would
embrace the minimum (barely sufficient)
amount of process that would be sufficient
for dealing with the risks in our particular
environment
Domains where human lives are at
risk might choose to employ a more
intense risk management process
24

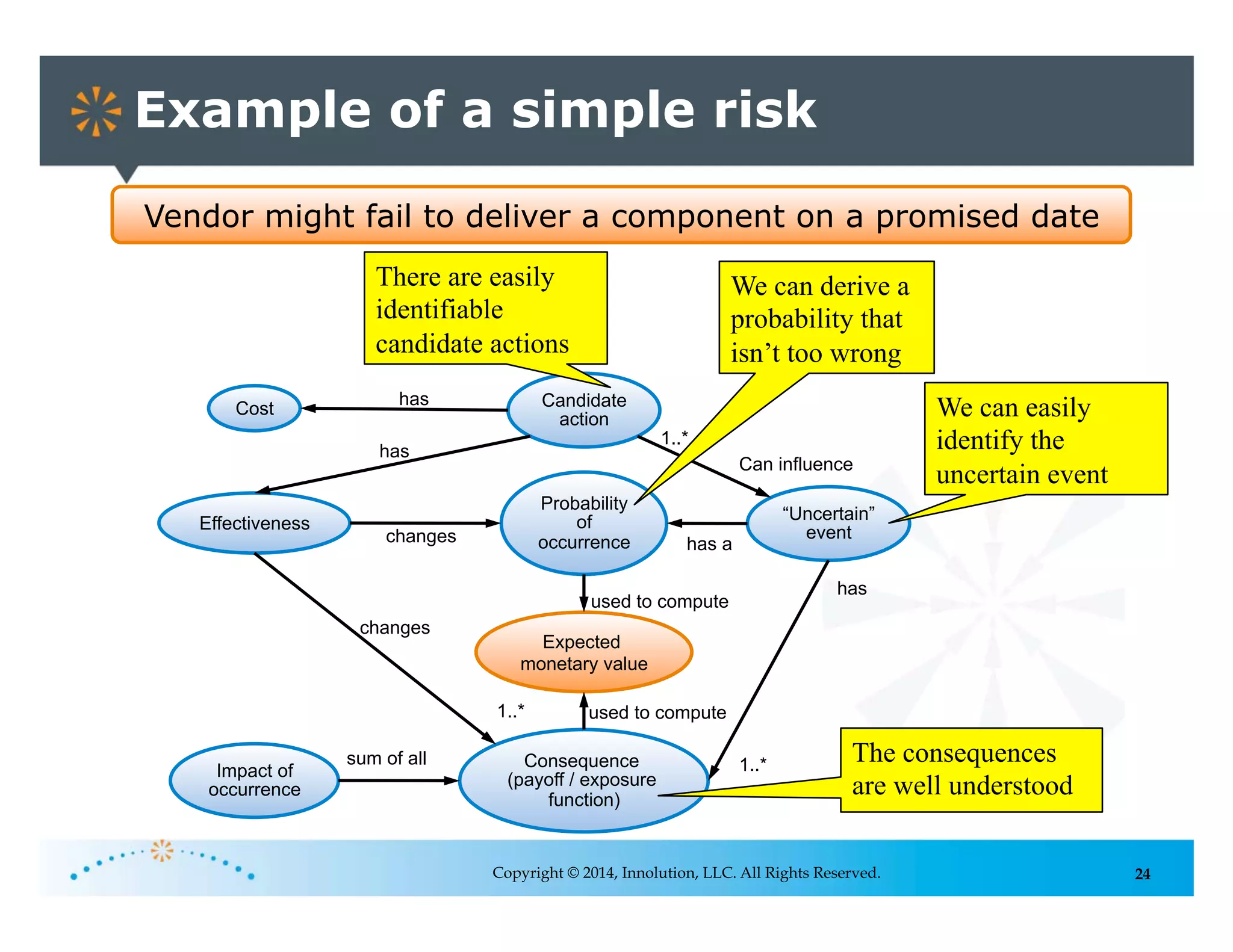

Example of a simple risk
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Vendor might fail to deliver a component on a promised date
“Uncertain”
event
Probability
of
occurrence
Consequence
(payoff / exposure
function)
Impact of
occurrence
sum of all
has a
has
Cost Candidate
action
Effectiveness
has
has
changes
changes
1..*
Can influence
1..*
1..*
Expected
monetary value
used to compute
used to compute
We can easily
identify the
uncertain event
We can derive a
probability that
isn’t too wrong
There are easily
identifiable
candidate actions
The consequences
are well understood
25

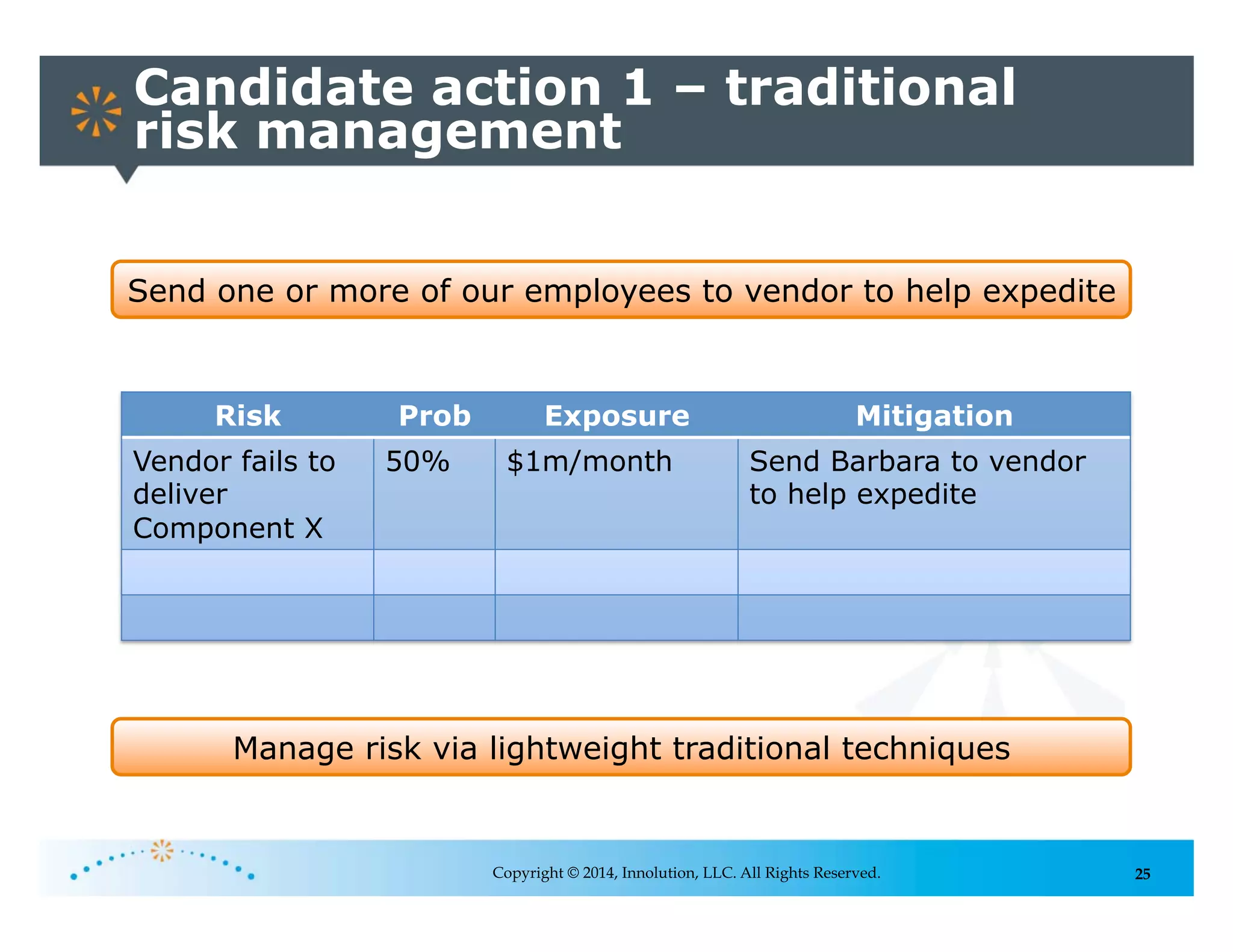

Candidate action 1 – traditional
risk management
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Send one or more of our employees to vendor to help expedite
Risk Prob Exposure Mitigation
Vendor fails to
deliver
Component X
50% $1m/month Send Barbara to vendor
to help expedite
Manage risk via lightweight traditional techniques
26

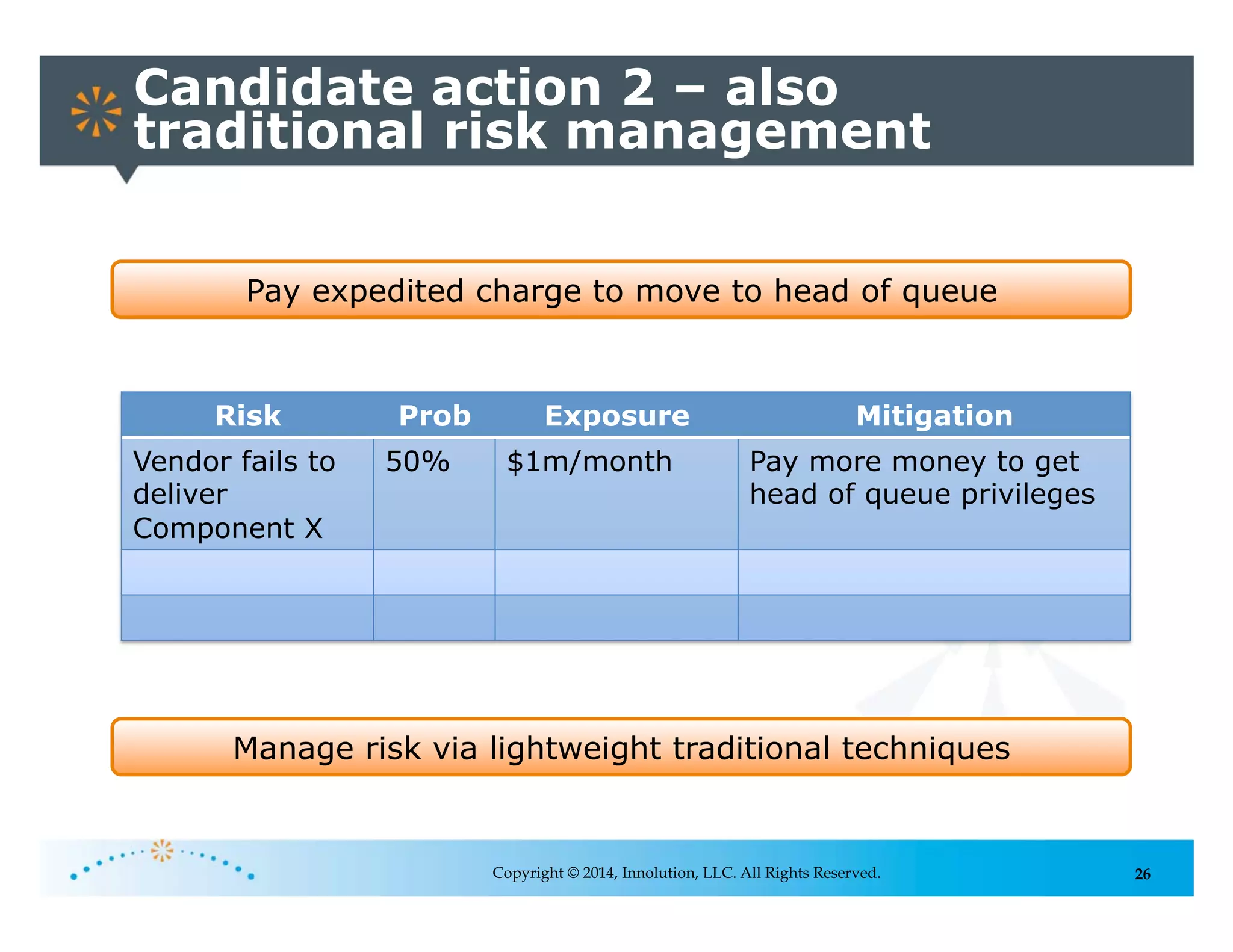

Candidate action 2 – also
traditional risk management
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Pay expedited charge to move to head of queue
Risk Prob Exposure Mitigation
Vendor fails to
deliver
Component X
50% $1m/month Pay more money to get
head of queue privileges
Manage risk via lightweight traditional techniques
27Copyright © 2014, Innolution, LLC. All Rights Reserved.
Managing Risk via
the Product Backlog
28Copyright © 2007-2014, Innolution, LLC. All Rights Reserved.
Value Cost
Dependencies
Knowledge
Risk
Resources

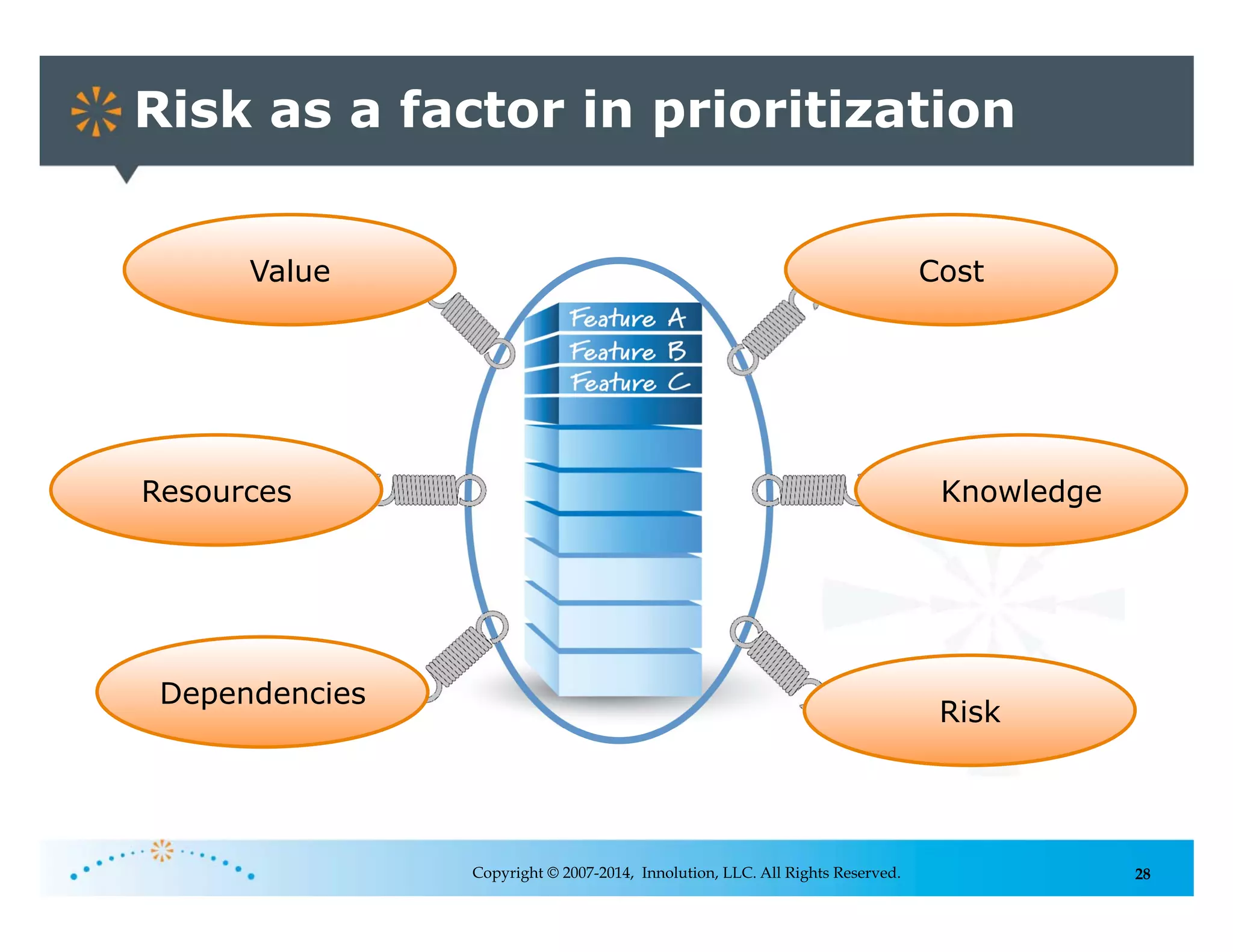

Risk as a factor in prioritization
29

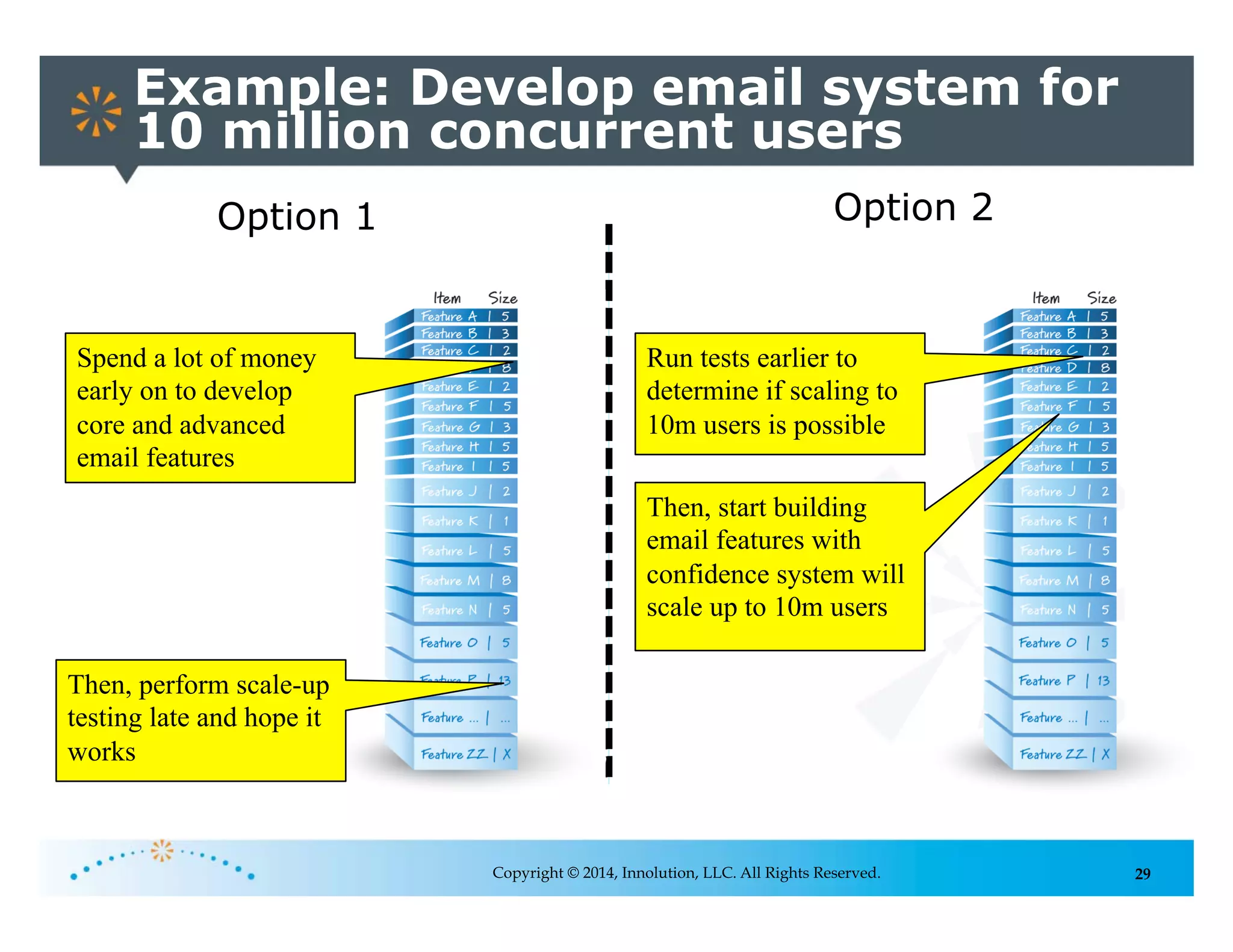

Example: Develop email system for
10 million concurrent users
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Option 1 Option 2
Spend a lot of money
early on to develop
core and advanced
email features
Then, perform scale-up
testing late and hope it
works
Run tests earlier to
determine if scaling to
10m users is possible
Then, start building
email features with
confidence system will
scale up to 10m users
30

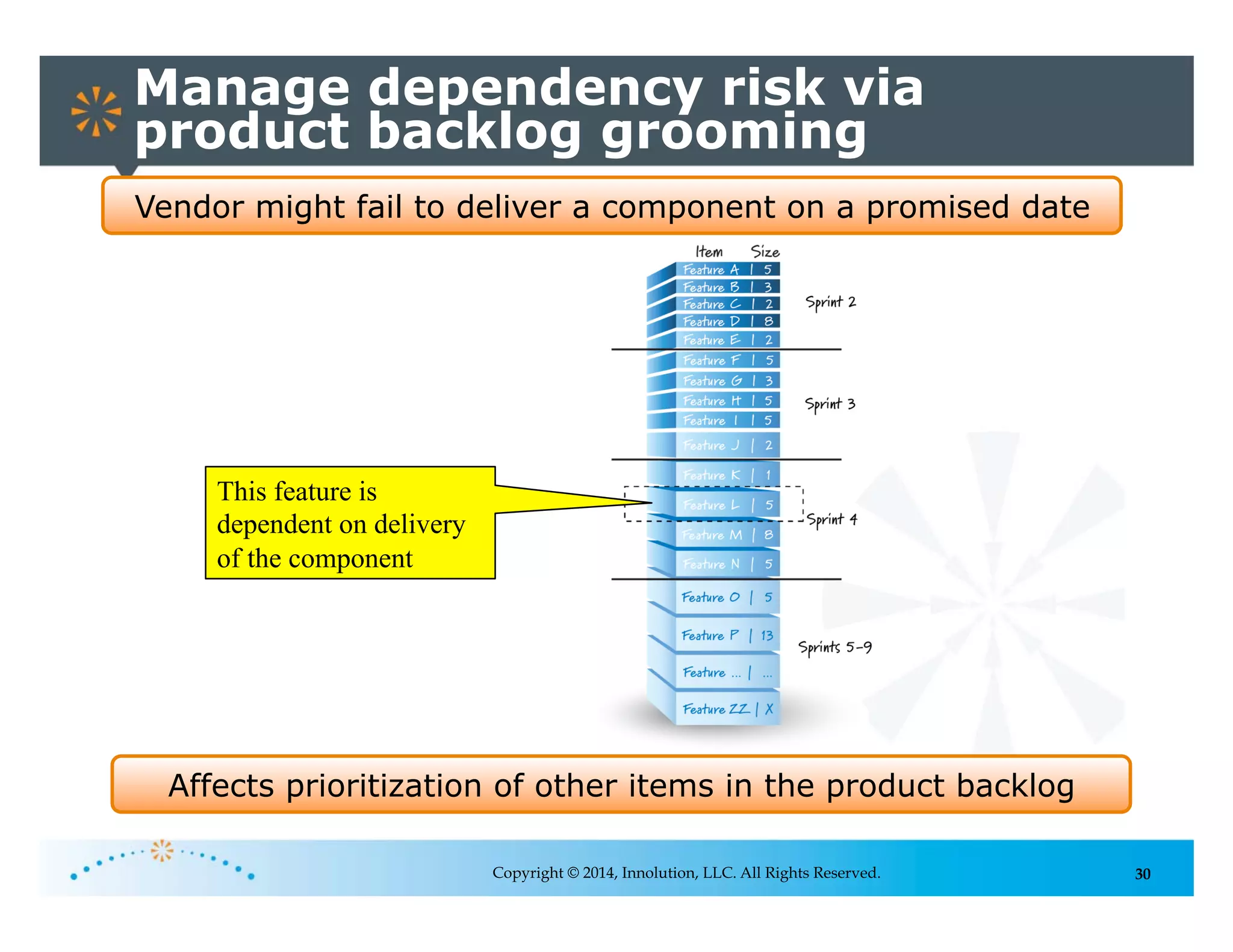

Manage dependency risk via
product backlog grooming
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Affects prioritization of other items in the product backlog
This feature is
dependent on delivery
of the component
Vendor might fail to deliver a component on a promised date
31

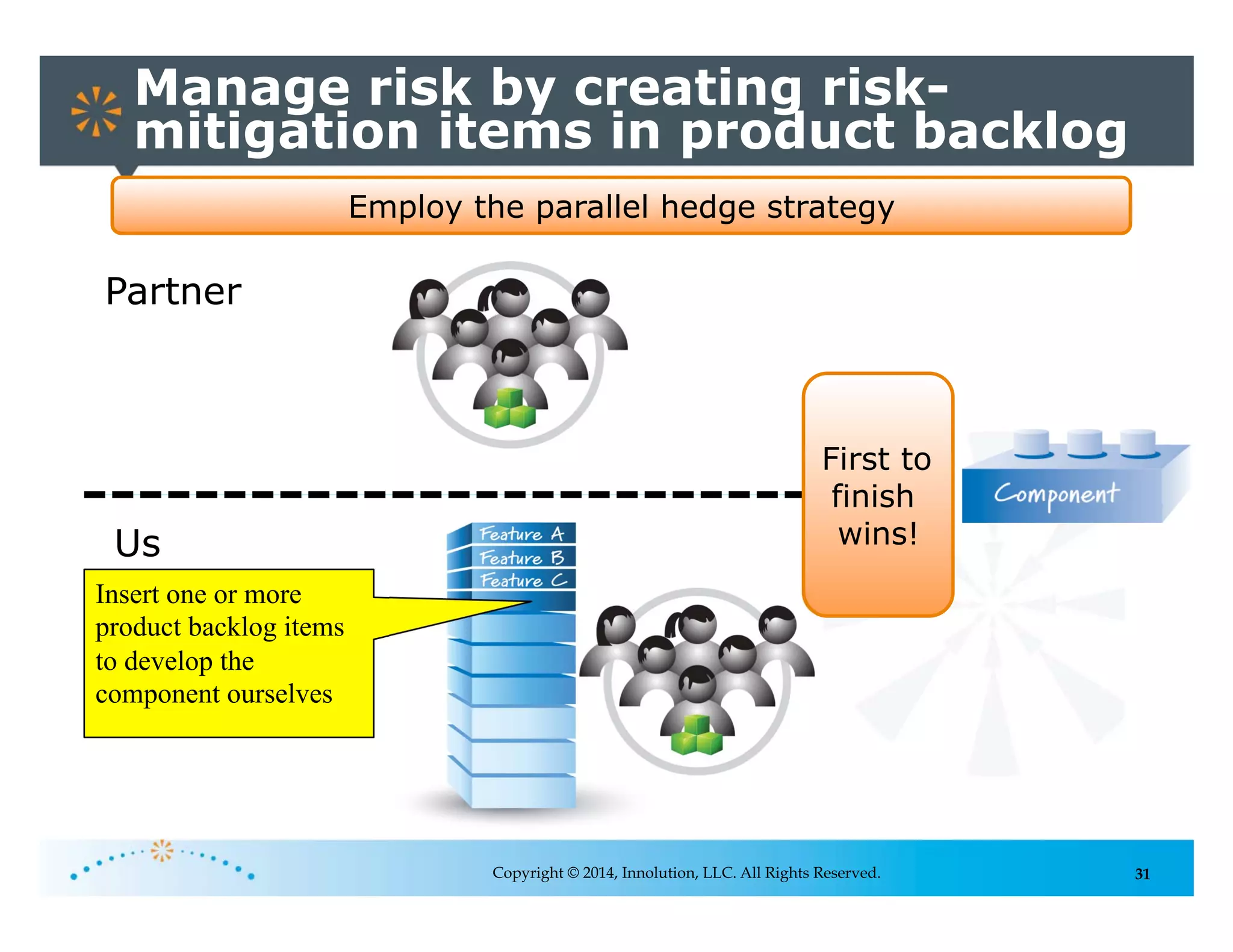

Manage risk by creating risk-
mitigation items in product backlog
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Employ the parallel hedge strategy
Us
Insert one or more
product backlog items
to develop the
component ourselves
First to
finish
wins!
Partner
32Copyright © 2014, Innolution, LLC. All Rights Reserved.
Using Agile to Avoid
Some Uncertain
Situations
33

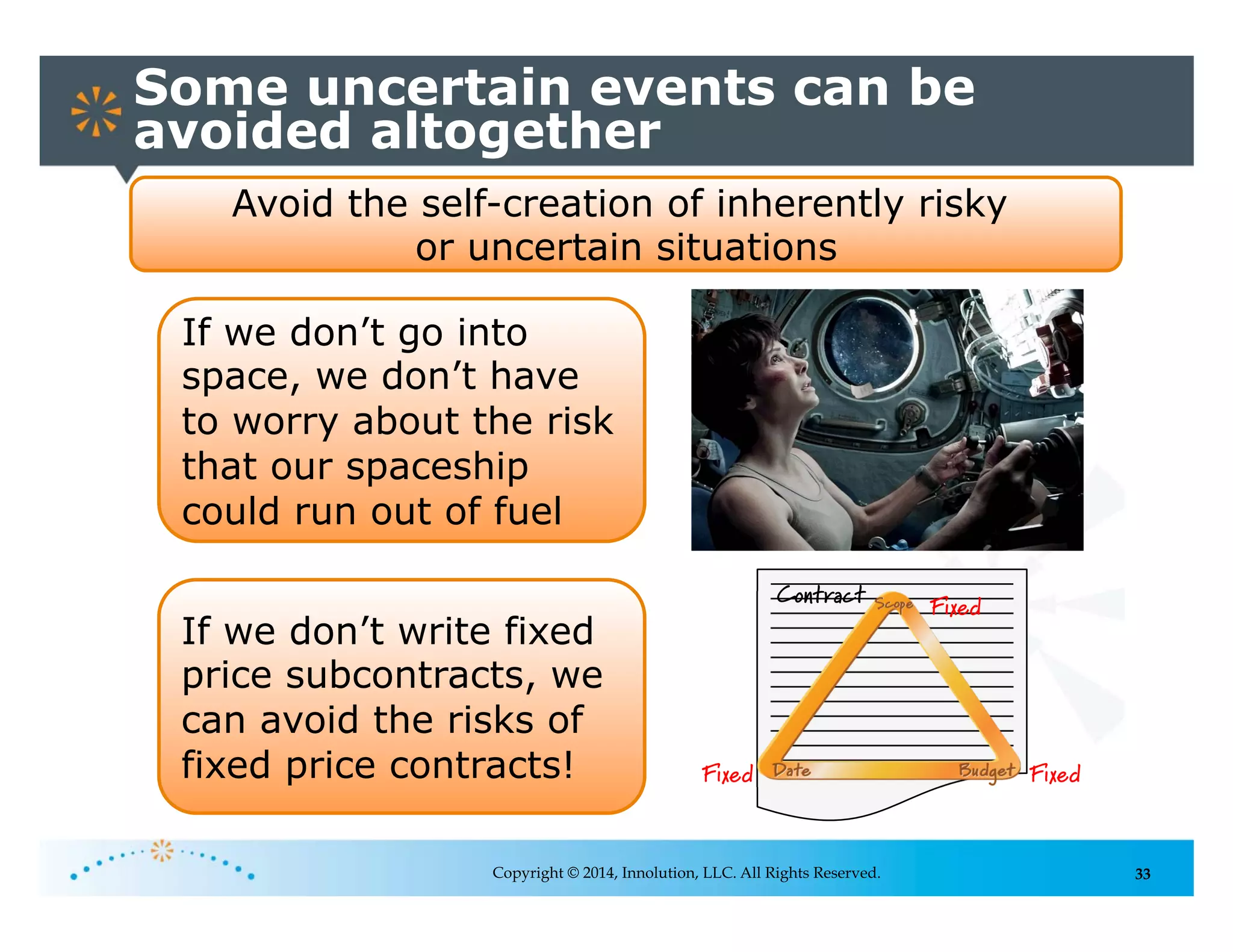

Some uncertain events can be
avoided altogether
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Avoid the self-creation of inherently risky
or uncertain situations
If we don’t go into
space, we don’t have
to worry about the risk
that our spaceship
could run out of fuel
Fixed
FixedFixed
Contract
If we don’t write fixed
price subcontracts, we
can avoid the risks of
fixed price contracts!
34Copyright © 2014, Innolution, LLC. All Rights Reserved.

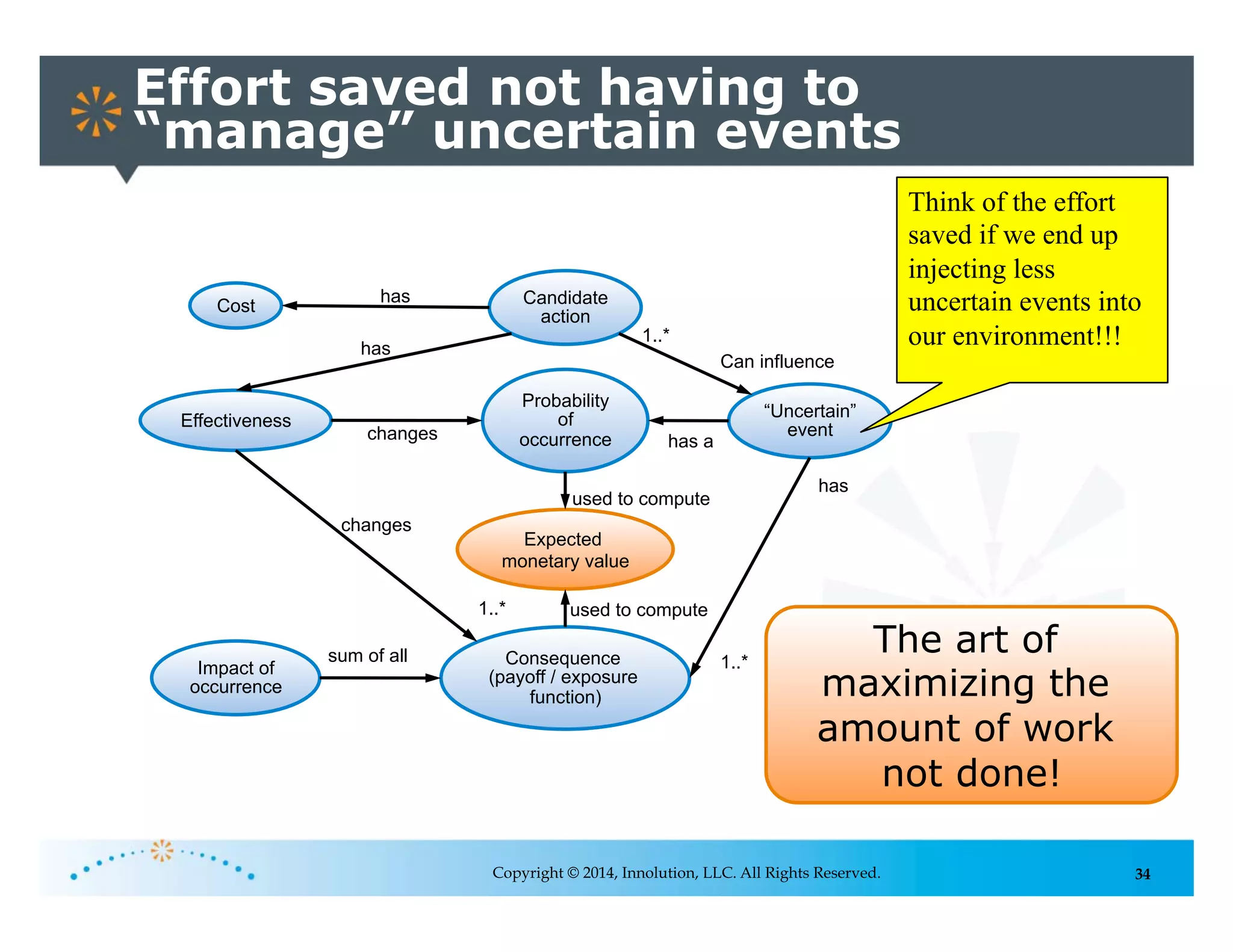

Effort saved not having to
“manage” uncertain events
“Uncertain”
event
Probability
of
occurrence
Consequence
(payoff / exposure
function)
Impact of
occurrence
sum of all
has a
has
Cost Candidate
action
Effectiveness
has
has
changes
changes
1..*
Can influence
1..*
1..*
Expected
monetary value
used to compute
used to compute
Think of the effort
saved if we end up
injecting less
uncertain events into
our environment!!!
The art of
maximizing the
amount of work
not done!
35Copyright © 2014, Innolution, LLC. All Rights Reserved.

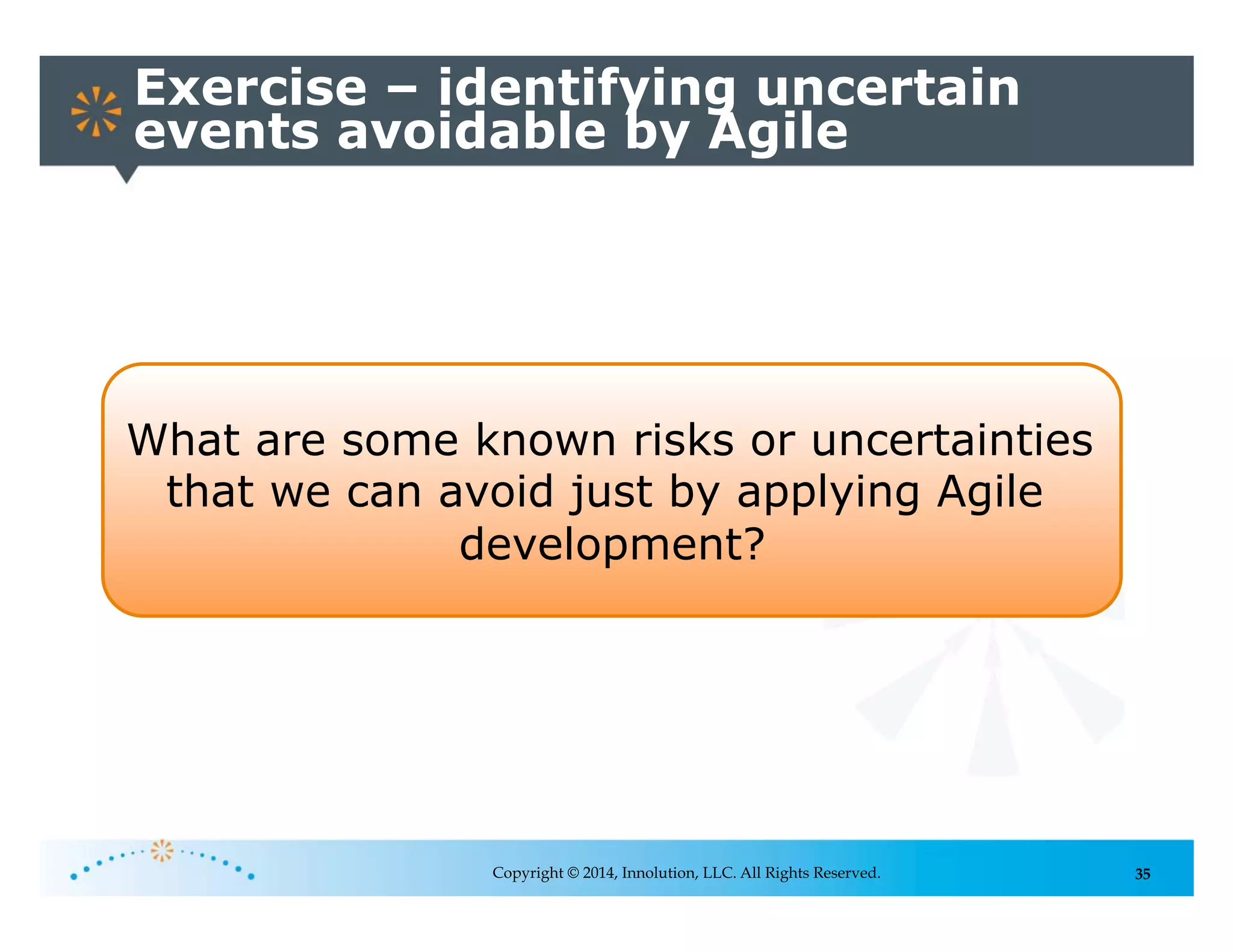

Exercise – identifying uncertain
events avoidable by Agile
What are some known risks or uncertainties
that we can avoid just by applying Agile
development?
36Copyright © 2014, Innolution, LLC. All Rights Reserved.
Agile Principle-
based Risk
Management
37
Applying agile principles to be
robust and antifragile
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Applying agile principles make the
development process robust and at times
antifragile to the disorder of uncertain events,
allowing us to avoid harm and reap the
benefits of uncertainty, without the need for
heavyweight risk management processes
38Copyright © 2014, Innolution, LLC. All Rights Reserved.
Failure to Apply
Scrum Principles
Throughout the
Value Chain
Variability and
Uncertainty
39Copyright © 2014, Innolution, LLC. All Rights Reserved.
All before any is “risk generating”
All-Before-Any:
assumes all” of one
activity can be
completed before
any of the next
activity begins
40

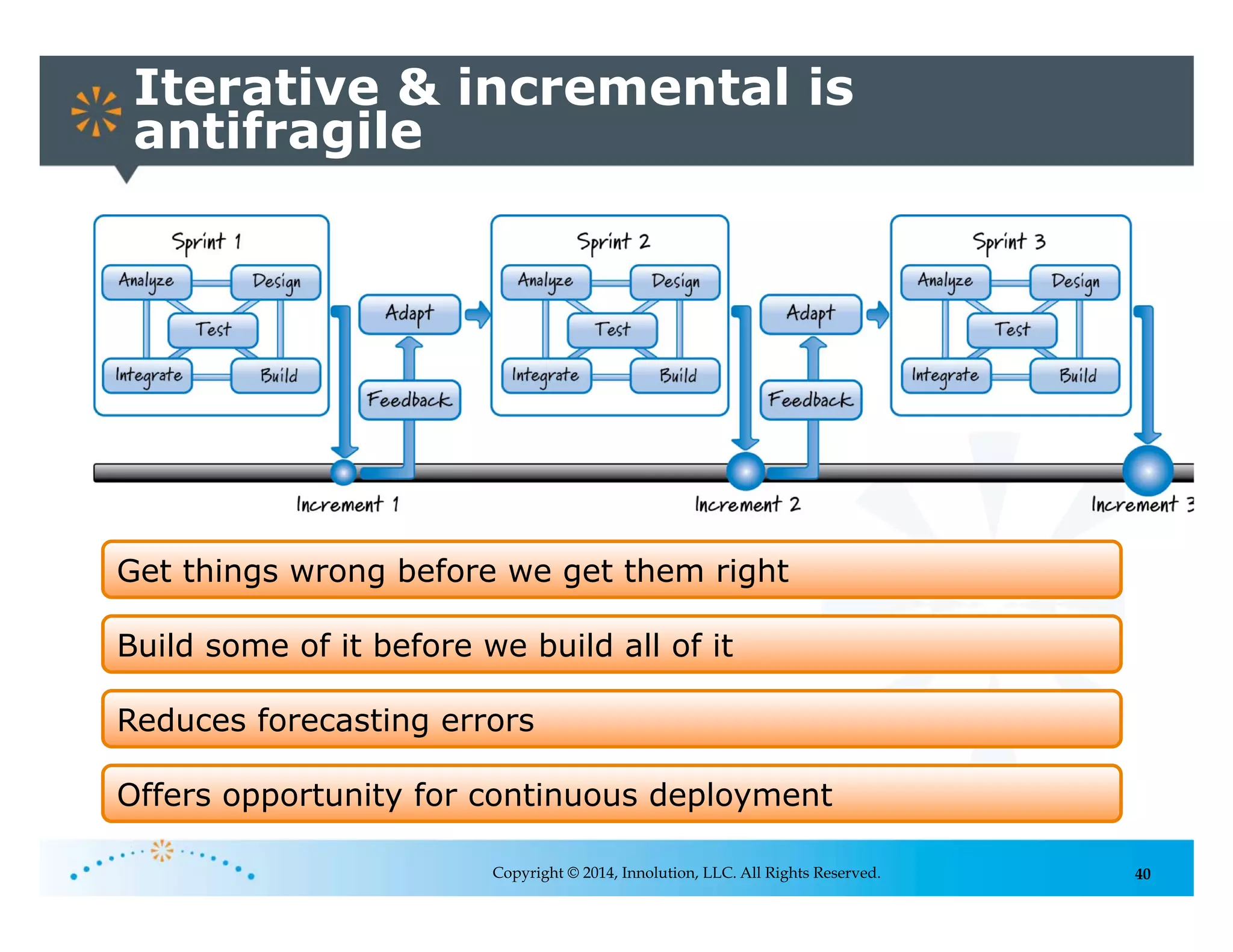

Iterative & incremental is
antifragile
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Get things wrong before we get them right
Build some of it before we build all of it
Reduces forecasting errors
Offers opportunity for continuous deployment
41
Inspect and adapt is antifragile
Copyright © 2014, Innolution, LLC. All Rights Reserved.
42Copyright © 2014, Innolution, LLC. All Rights Reserved.
Failure to Apply
Scrum Principles
Throughout the
Value Chain
Prediction and
Adaptation
43
Risk of trying to get it right

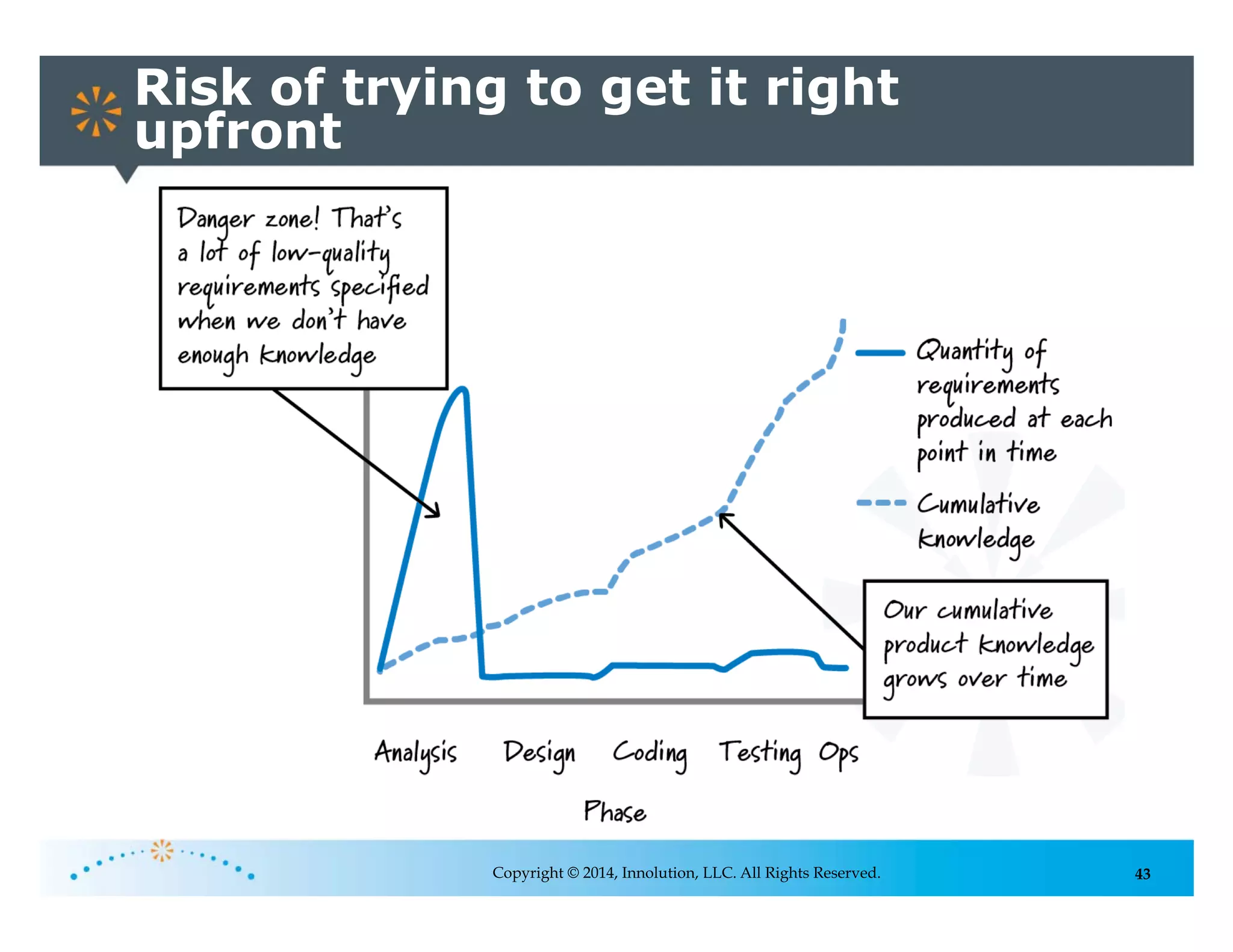

upfront
Copyright © 2014, Innolution, LLC. All Rights Reserved.
44

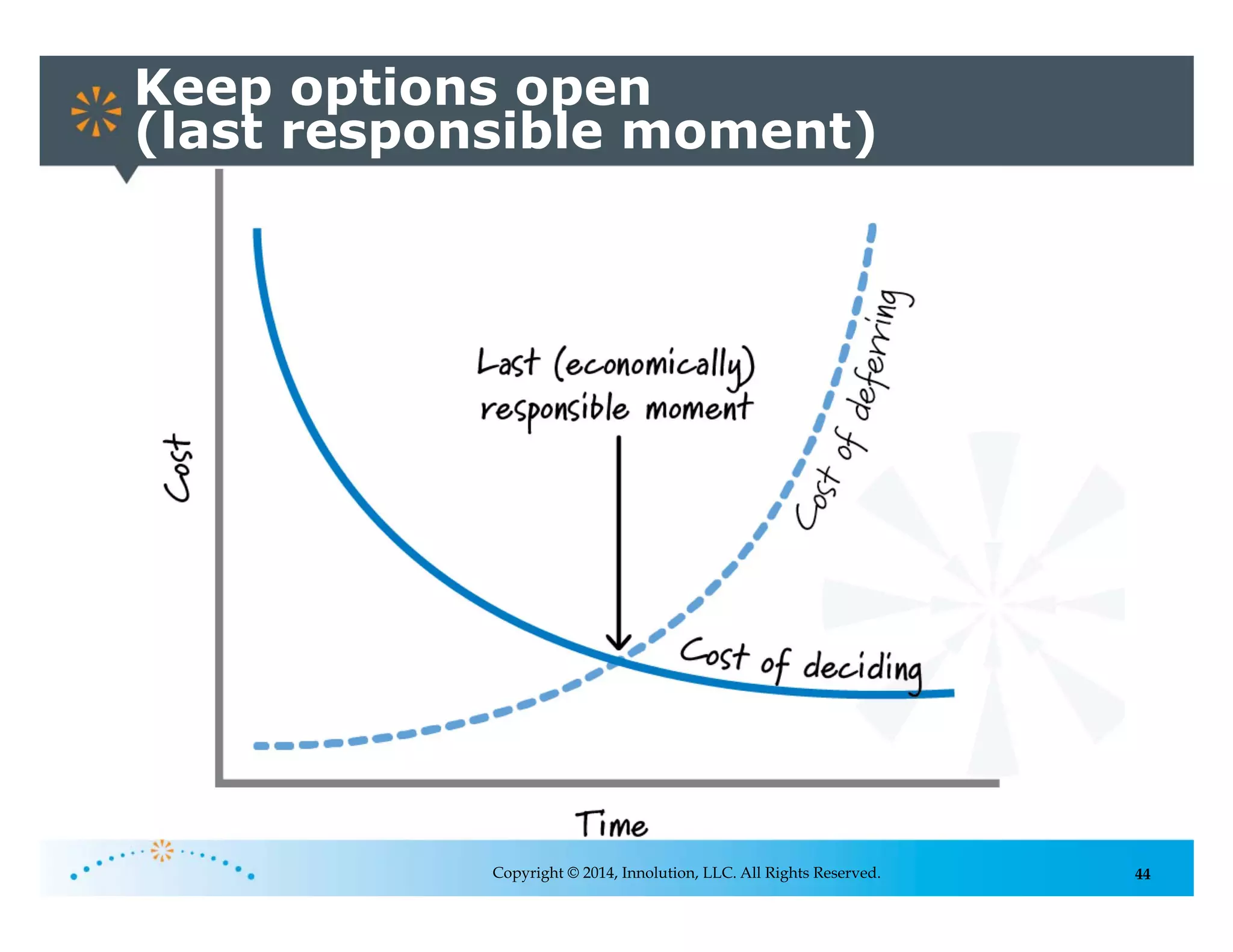

Keep options open
(last responsible moment)
Copyright © 2014, Innolution, LLC. All Rights Reserved.
45
Exercise – Architecture A vs. B
Copyright © 2014, Innolution, LLC. All Rights Reserved.

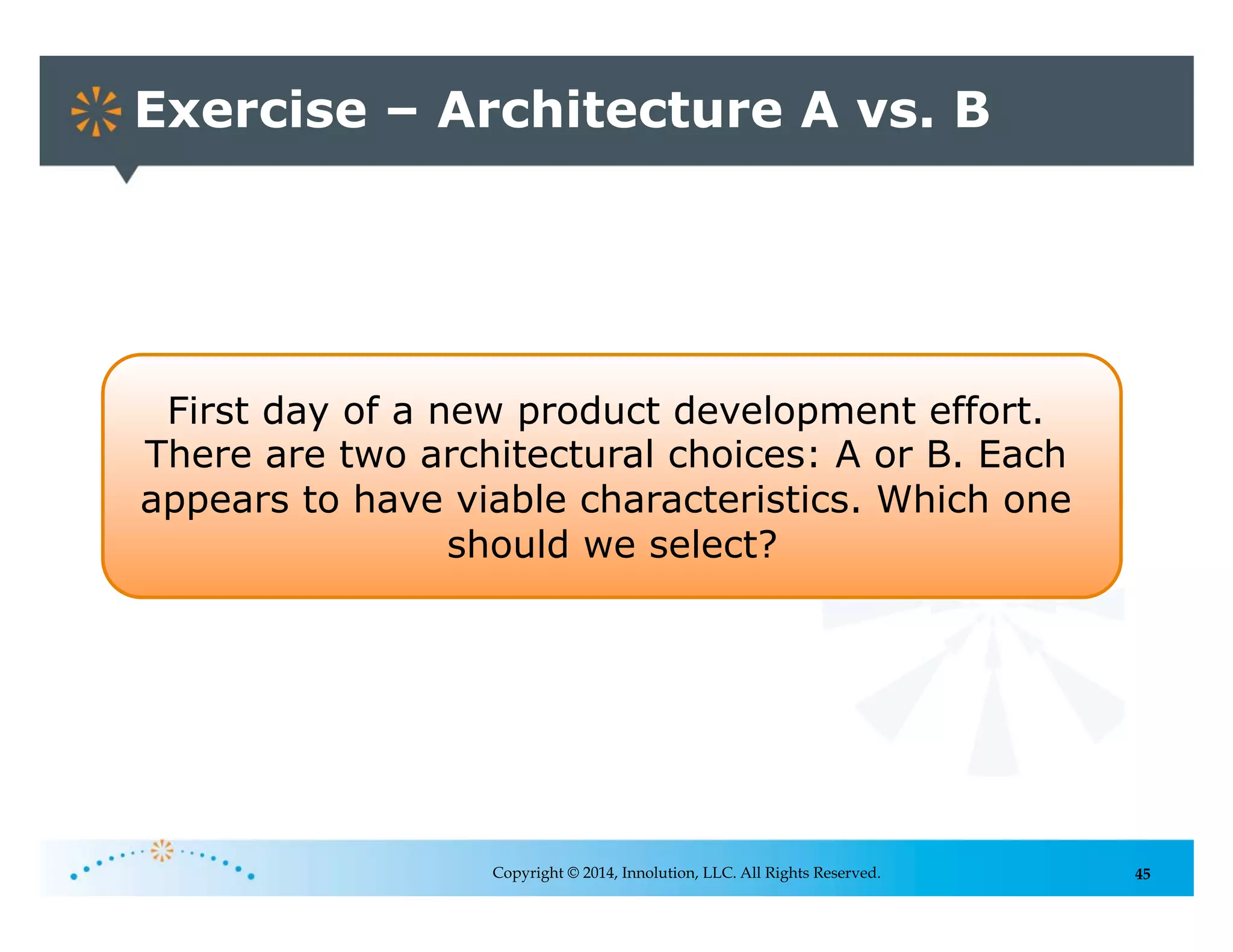

First day of a new product development effort.
There are two architectural choices: A or B. Each
appears to have viable characteristics. Which one
should we select?
46

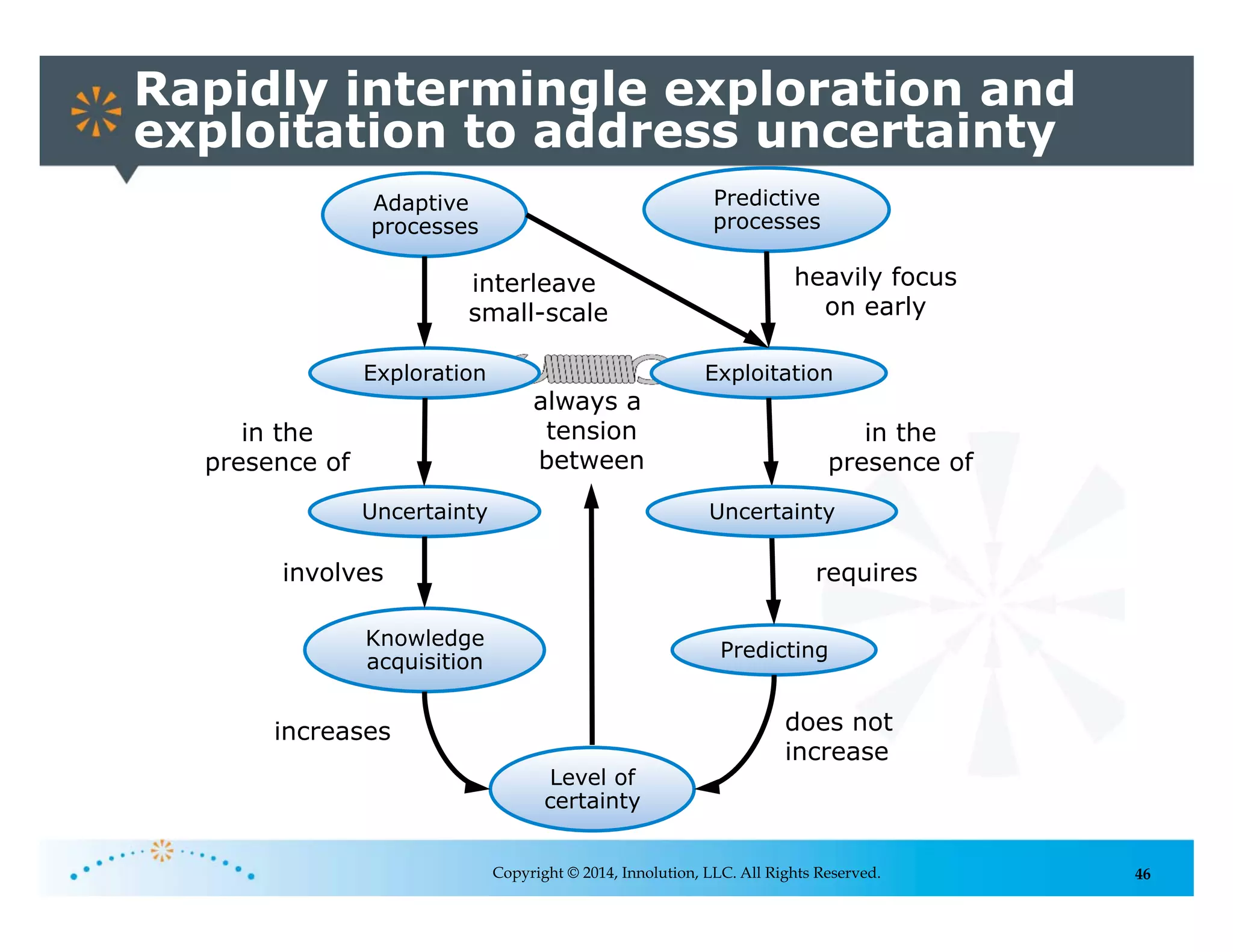

Rapidly intermingle exploration and
exploitation to address uncertainty
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Knowledge
acquisition
Predicting
Exploration Exploitation
always a
tension
between
requiresinvolves
in the
presence of
UncertaintyUncertainty
in the
presence of
increases
Level of
certainty
does not
increase
Adaptive
processes
Predictive
processes
heavily focus
on early
interleave
small-scale
47
Real options
Copyright © 2014, Innolution, LLC. All Rights Reserved.

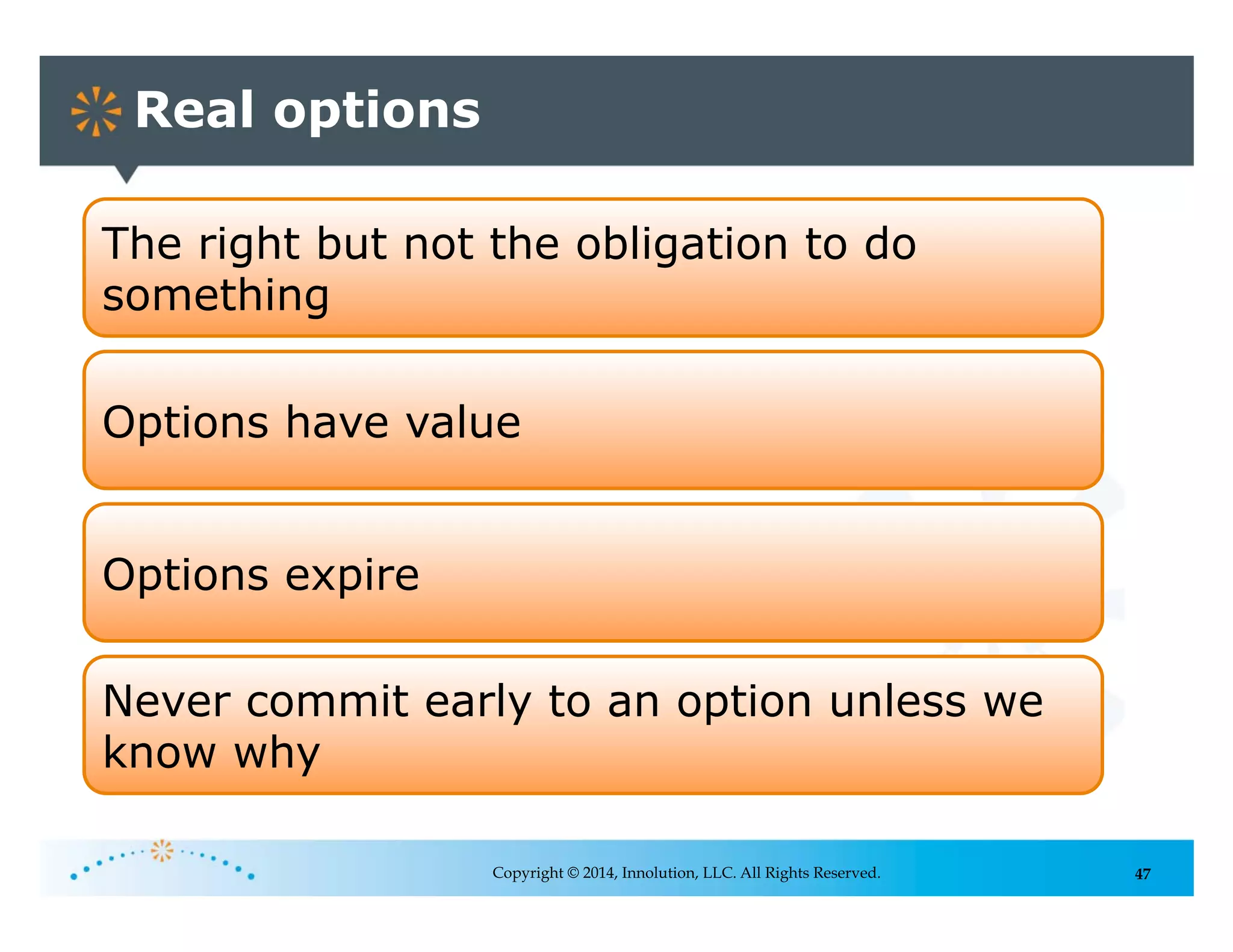

The right but not the obligation to do
something
Options have value
Options expire
Never commit early to an option unless we
know why
48

Managing change risk during a
traditional development project
Copyright © 2014, Innolution, LLC. All Rights Reserved.
49

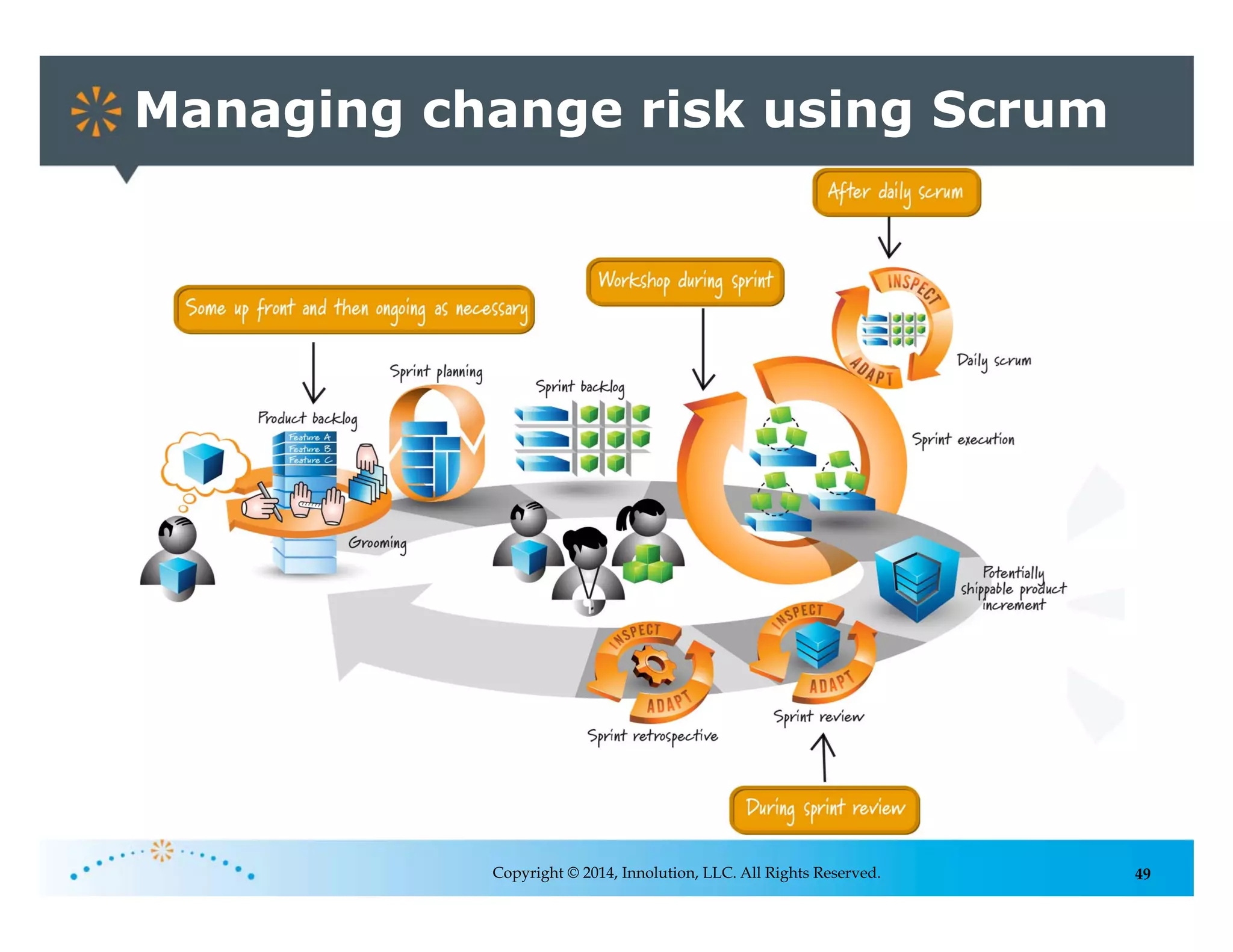

Managing change risk using Scrum
Copyright © 2014, Innolution, LLC. All Rights Reserved.
50Copyright © 2014, Innolution, LLC. All Rights Reserved.
Failure to Apply
Scrum Principles
Throughout the
Value Chain
Validated Learning
51

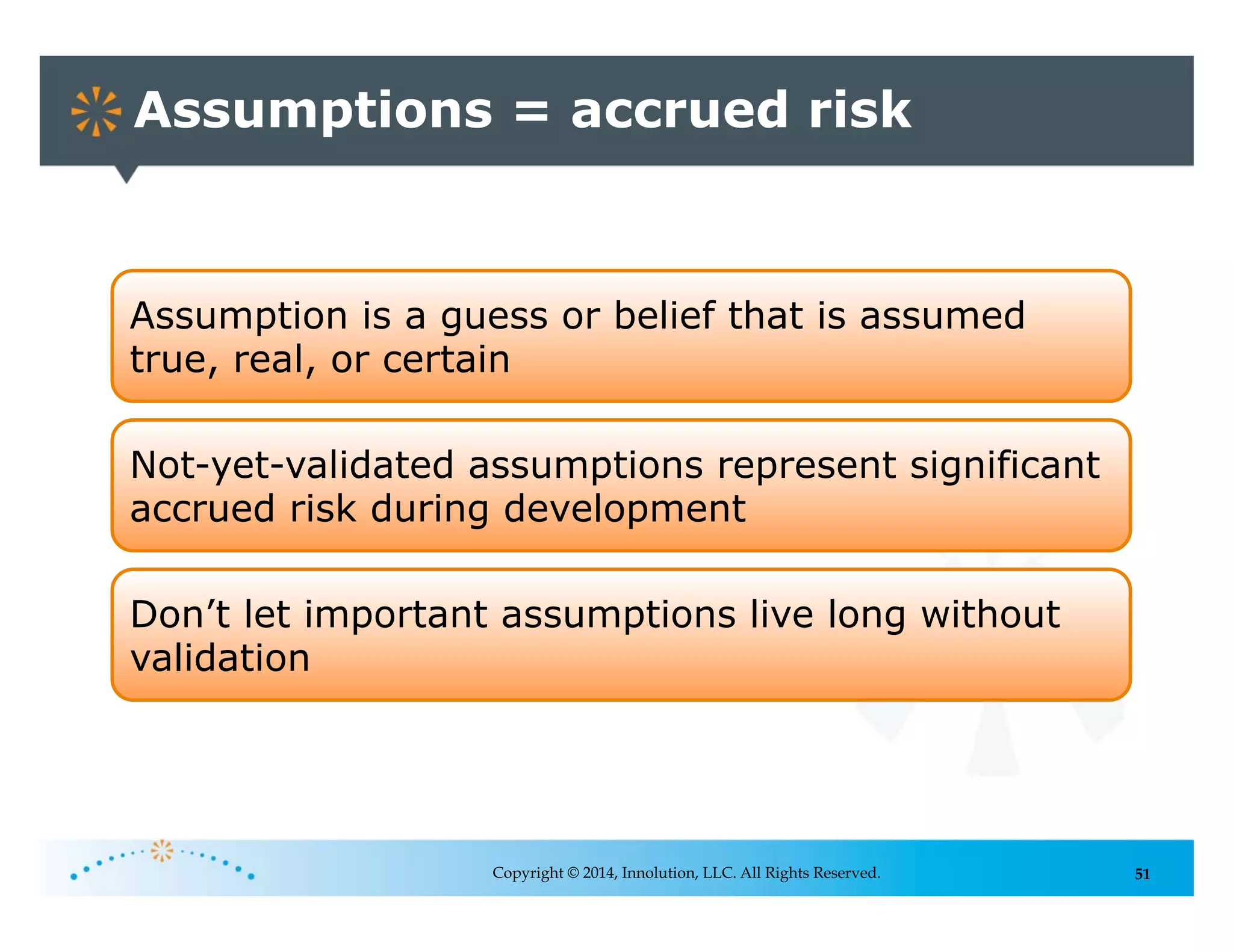

Assumptions = accrued risk
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Assumption is a guess or belief that is assumed
true, real, or certain
Not-yet-validated assumptions represent significant
accrued risk during development
Don’t let important assumptions live long without
validation
52
Reduce risk by going fast through
the loop
Copyright © 2014, Innolution, LLC. All Rights Reserved.
53

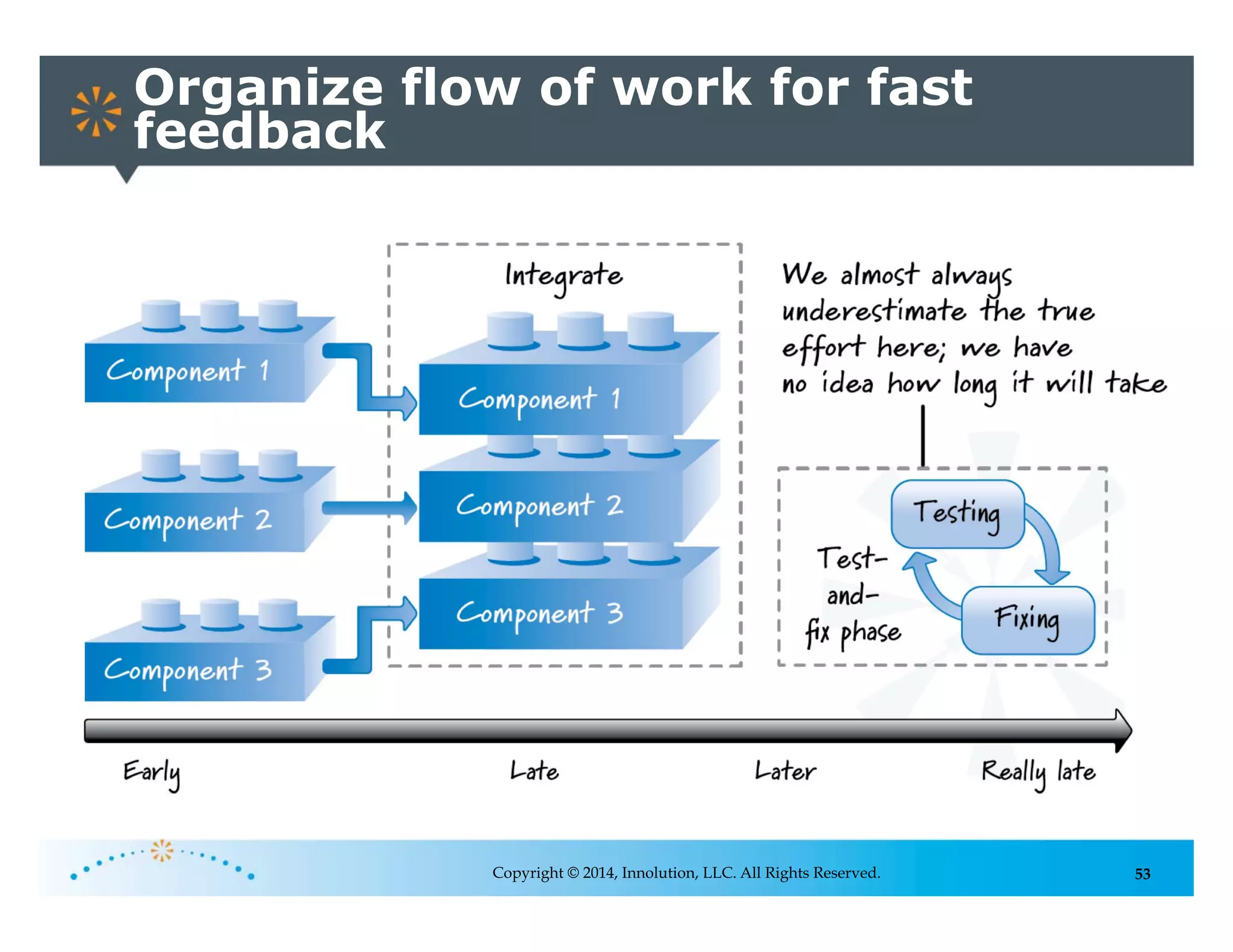

Organize flow of work for fast
feedback
Copyright © 2014, Innolution, LLC. All Rights Reserved.
54
Fast feedback is antifragile
Copyright © 2014, Innolution, LLC. All Rights Reserved.

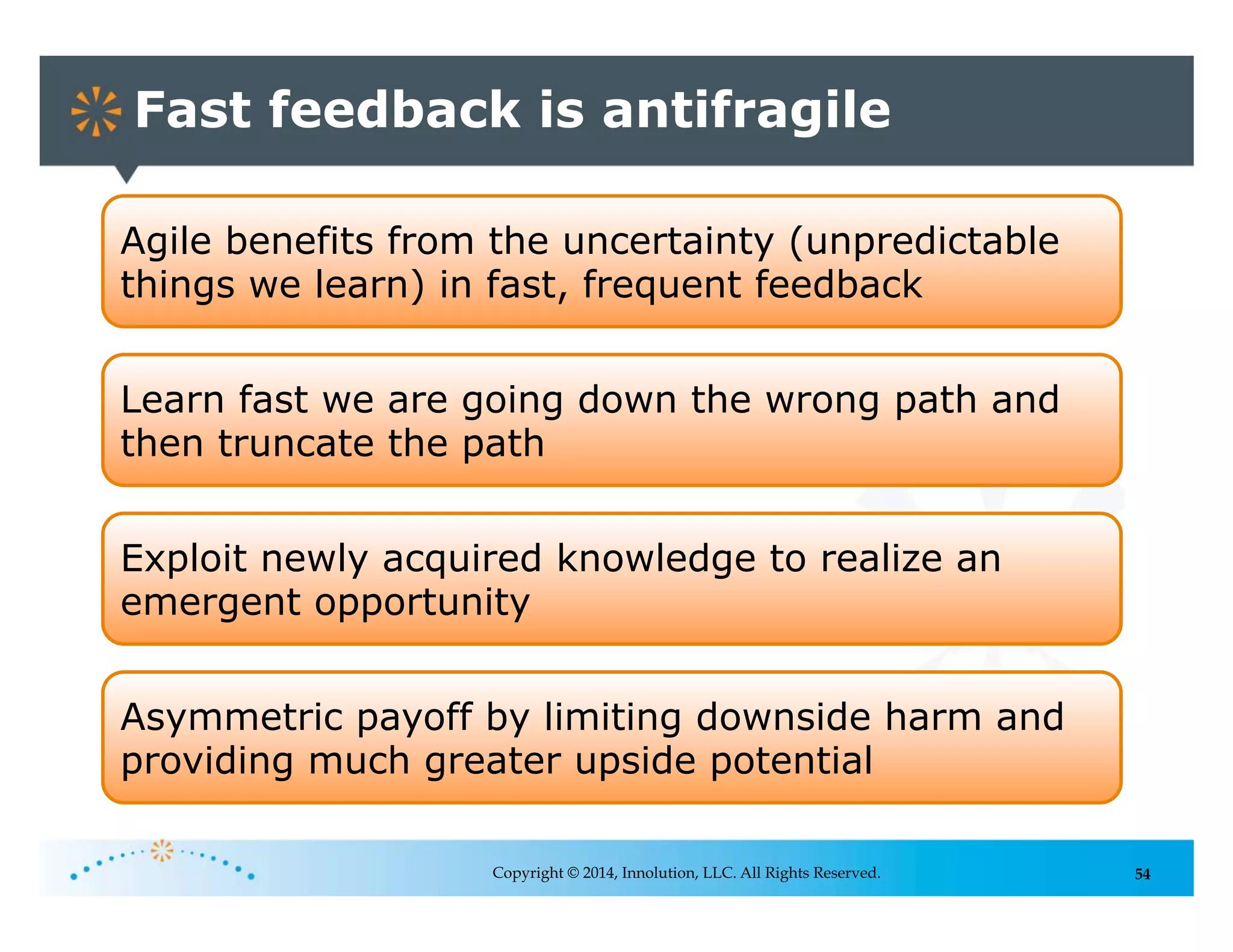

Agile benefits from the uncertainty (unpredictable
things we learn) in fast, frequent feedback
Learn fast we are going down the wrong path and
then truncate the path
Exploit newly acquired knowledge to realize an
emergent opportunity
Asymmetric payoff by limiting downside harm and
providing much greater upside potential
55Copyright © 2014, Innolution, LLC. All Rights Reserved.
Failure to Apply
Scrum Principles
Throughout the
Value Chain
Work in Process
(WIP)
56
Use economically sensible
(typically smaller) batch sizes
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Reduced cycle time
Reduced flow variability
Accelerated feedback
Lower risk of failure
Reduced overhead
Increased motivation & urgency
Reduced cost and schedule growth
Source: Reinertsen, Donald, The Principles of Product Development Flow: Second Generation Lean Product
Development, Celeritas Publishing, 2009.
57

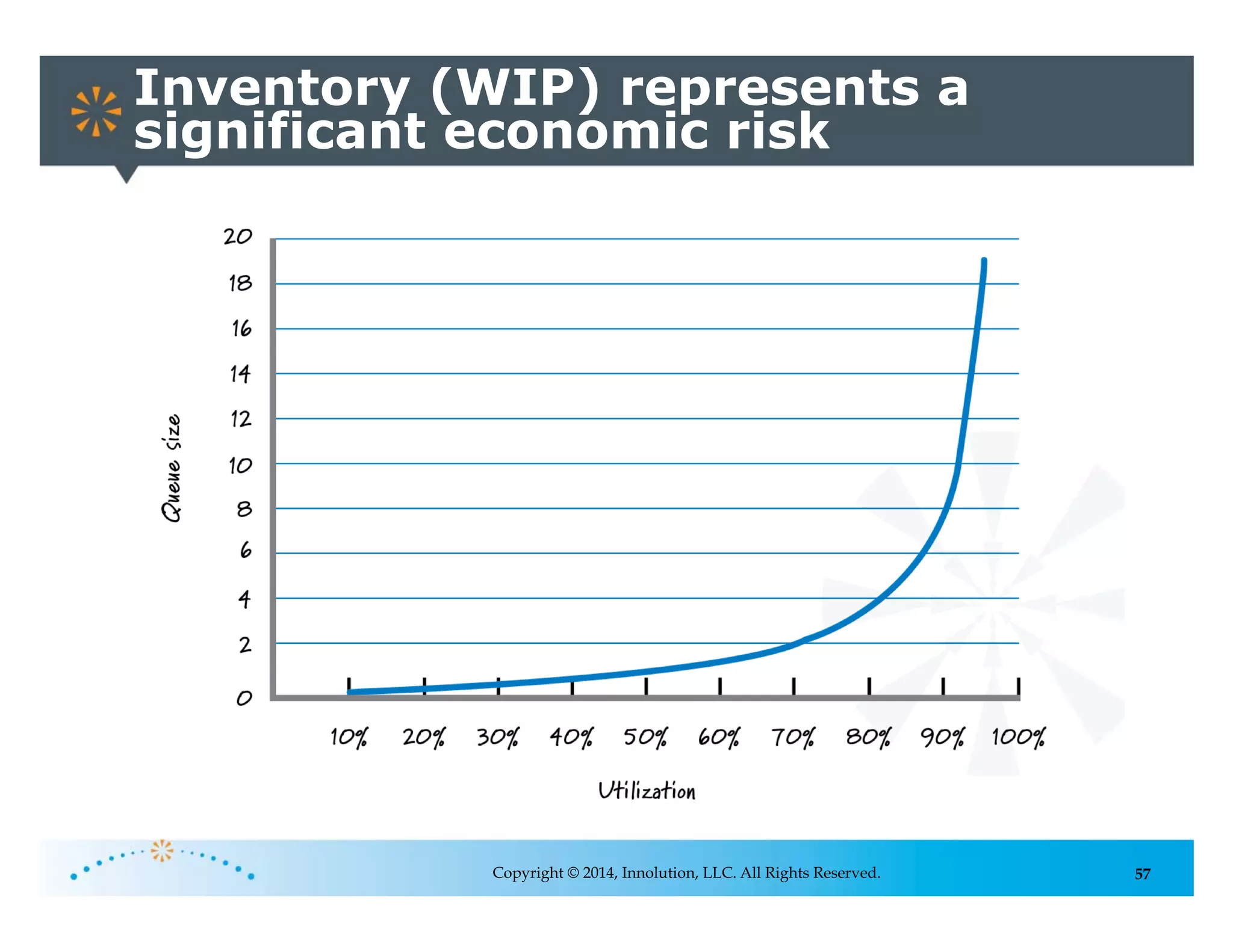

Inventory (WIP) represents a
significant economic risk
Copyright © 2014, Innolution, LLC. All Rights Reserved.
58Copyright © 2014, Innolution, LLC. All Rights Reserved.
Failure to Apply
Scrum Principles
Throughout the
Value Chain
Planning Risks
59

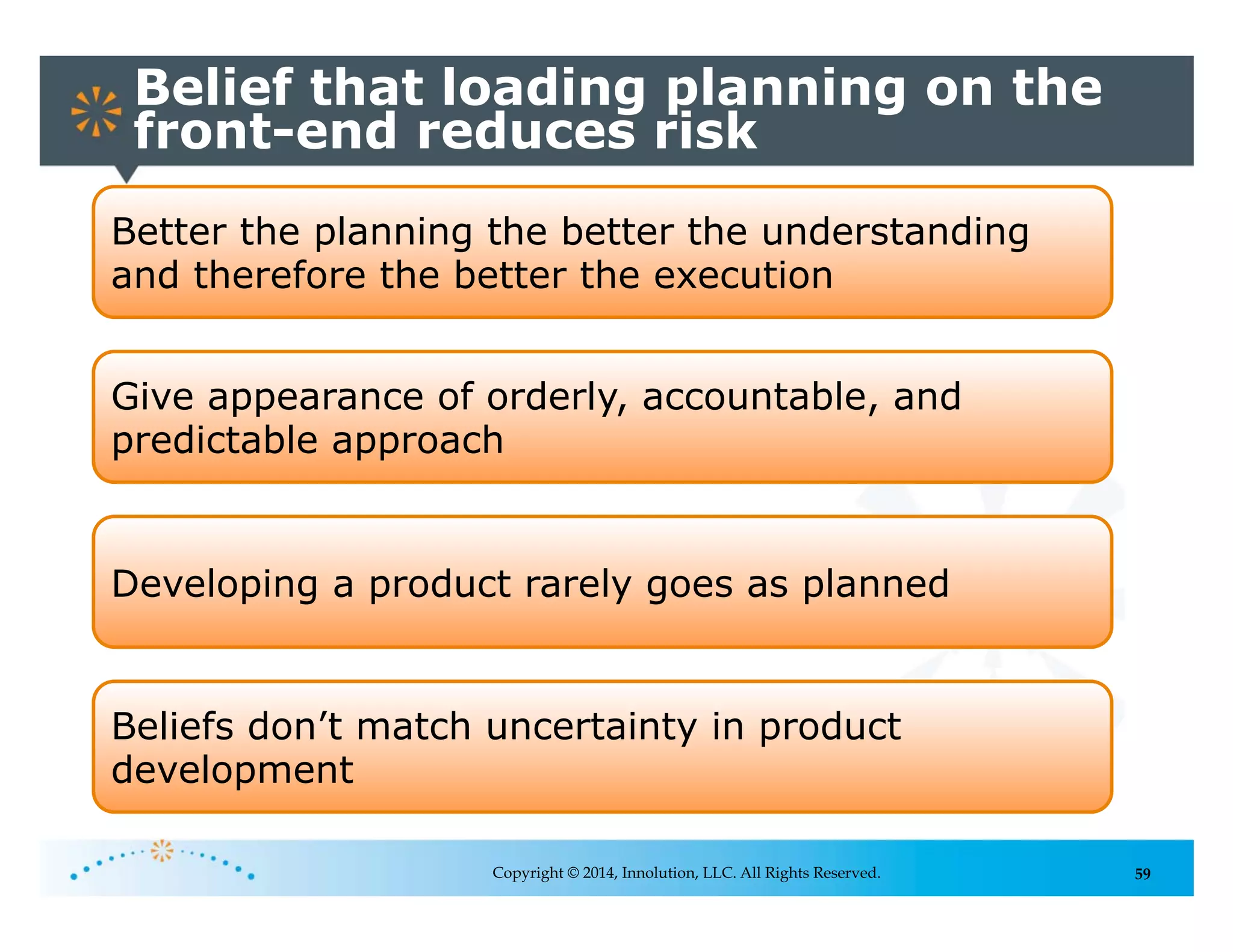

Belief that loading planning on the
front-end reduces risk
Copyright © 2014, Innolution, LLC. All Rights Reserved.
Better the planning the better the understanding
and therefore the better the execution
Give appearance of orderly, accountable, and
predictable approach
Developing a product rarely goes as planned
Beliefs don’t match uncertainty in product
development
60
Scope is the risk-reducing degree
of freedom
Copyright © 2014, Innolution, LLC. All Rights Reserved.

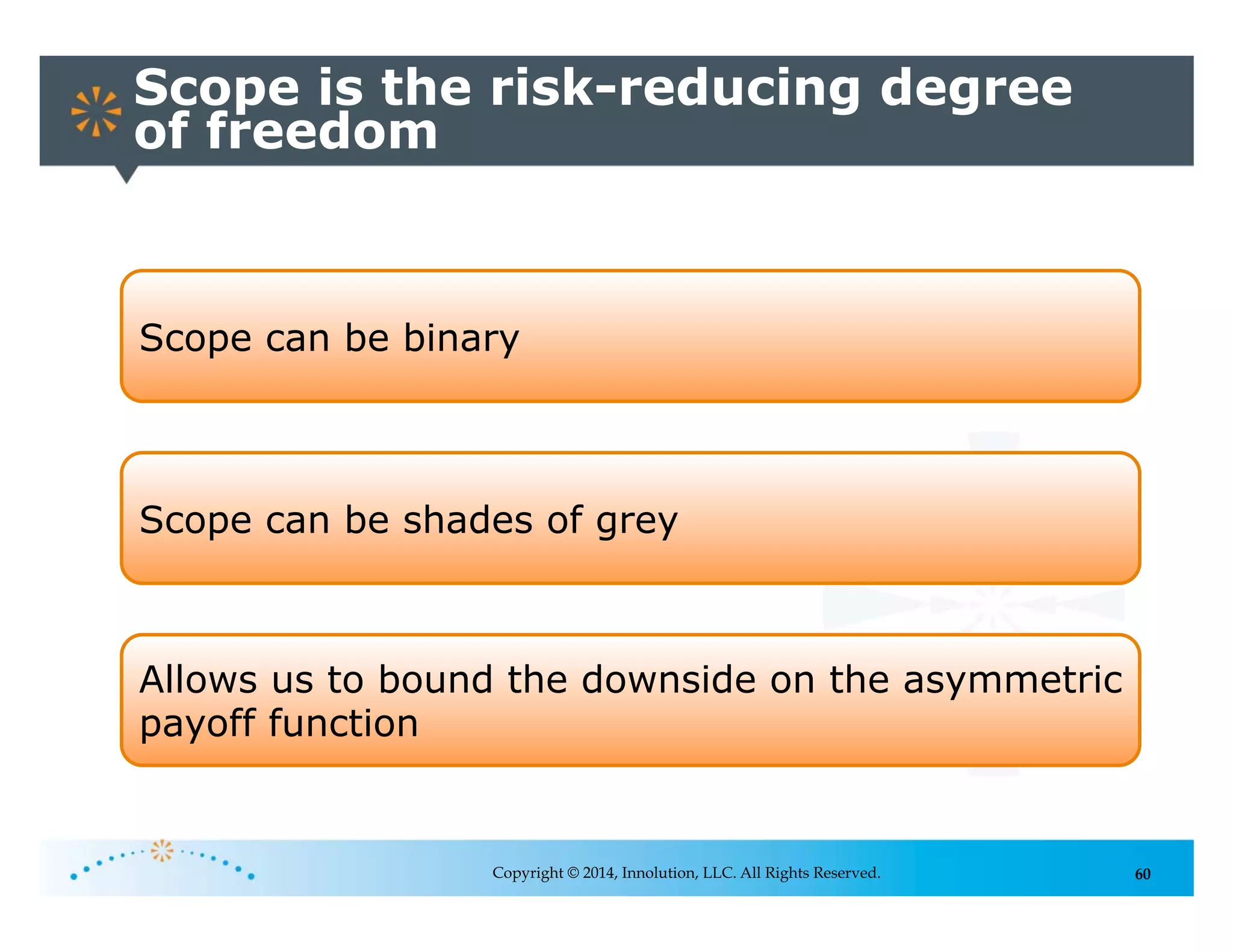

Scope can be binary
Scope can be shades of grey
Allows us to bound the downside on the asymmetric
payoff function
61

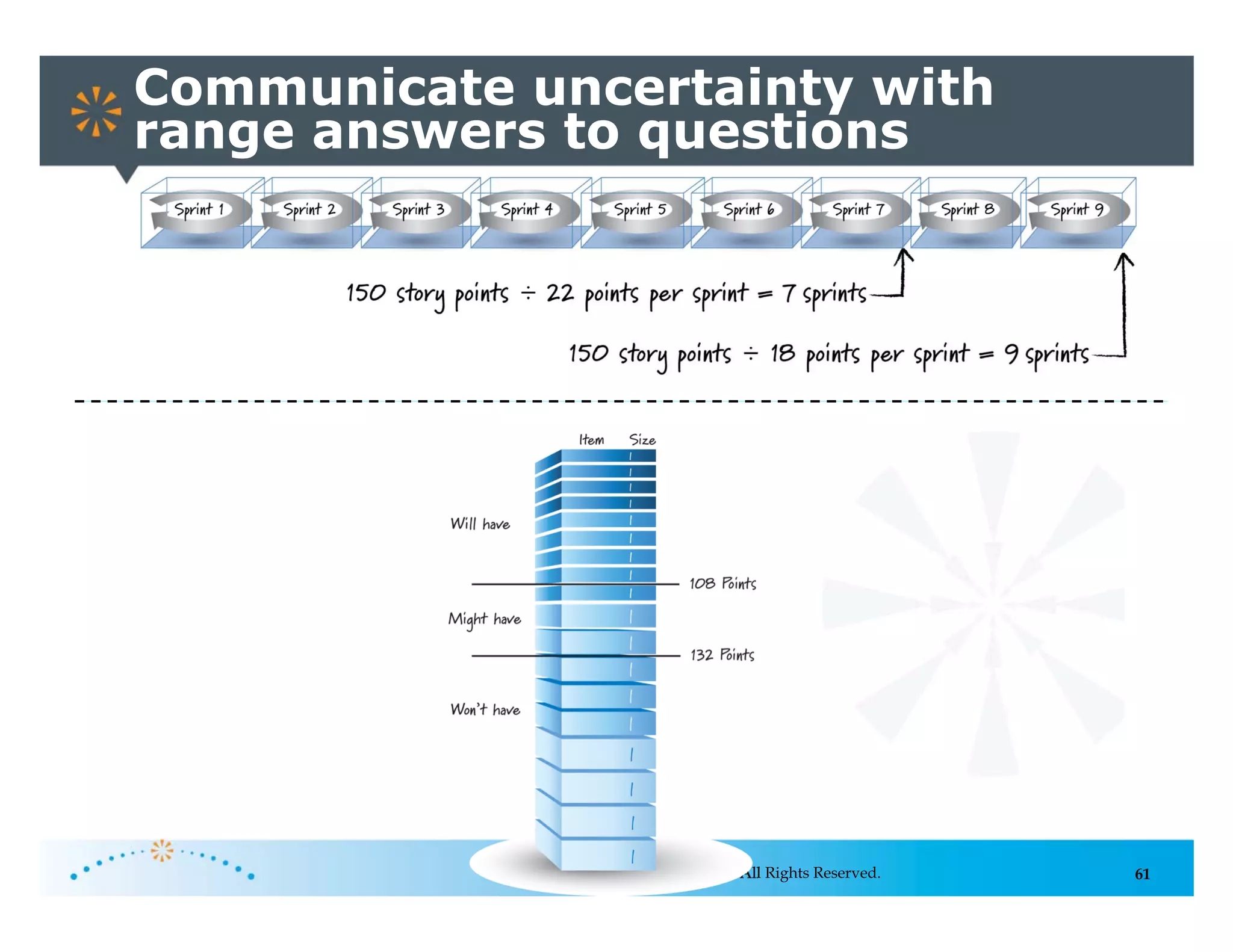

Communicate uncertainty with
range answers to questions
Copyright © 2014, Innolution, LLC. All Rights Reserved.
62
Teams with T-Shaped skills
Copyright © 2014, Innolution, LLC. All Rights Reserved.

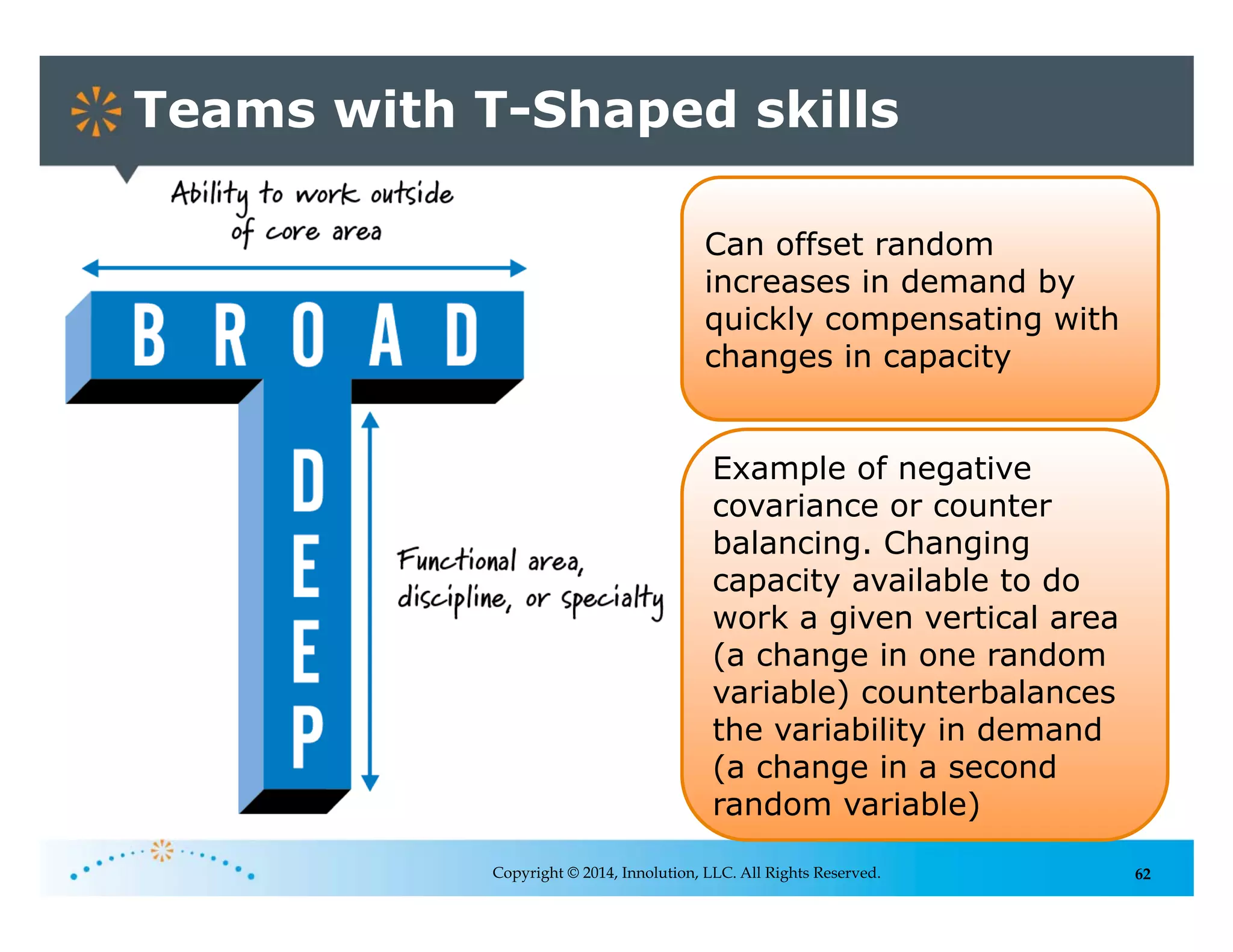

Can offset random
increases in demand by
quickly compensating with
changes in capacity
Example of negative
covariance or counter
balancing. Changing
capacity available to do
work a given vertical area
(a change in one random
variable) counterbalances
the variability in demand
(a change in a second
random variable)
63Copyright © 2014, Innolution, LLC. All Rights Reserved.
Contact Info for Ken Rubin
Email: krubin@innolution.com
Website: www.innolution.com
Phone: (303) 827-3333
LinkedIn: www.linkedin.com/in/kennethrubin
Twitter: www.twitter.com/krubinagile
Facebook: www.facebook.com/InnolutionLLC
Google+ plus.google.com/+KennyRubin1/
Essential Scrum: A Practical
Guide to the Most Popular
Agile Process
www.essentialscrum.com
Comparative Agility Website www.comparativeagility.com

Agile IS Risk Management - Agile 2014 - Antifragile

  • 1.
    1Copyright © 2014,Innolution, LLC. All Rights Reserved. Agile IS Risk Management Agile 2014 Orlando, FL July 29, 2014 by Ken Rubin
  • 2.
    2Copyright © 2007-2014,Innolution, LLC. All Rights Reserved. Background of Ken RubinAuthorTrainer Coach Exp Trained more than 20,000 people Coach developers and executives 1st Managing Director 1st Scrum project was in 2000 for bioinformatics
  • 3.
    3Copyright © 2014,Innolution, LLC. All Rights Reserved. Agenda Uncertain Events Managing Risk via the Product Backlog Maximize Expected Monetary Value Using Agile to Avoid Some Uncertain Situations Traditional Risk Management Agile Principle-based Risk Management
  • 4.
    4 Some questions… anddiscussion… Copyright © 2014, Innolution, LLC. All Rights Reserved. We outsource stress-testing of our application to a third- party and there is a risk it won’t be done when promised. How do we handle this? How do we manage the risks of a fixed-price contract? Should we try to avoid the risk of building the wrong product by working longer and harder up front to get its specification right? We lack knowledge to make an informed technical choice. So there is a risk of a bad decision. How should we proceed?
  • 5.
    5 How to handlethese risks — a roadmap for our discussion Copyright © 2014, Innolution, LLC. All Rights Reserved. When appropriate, apply simple traditional risk management techniques in a good-enough (barely sufficient) manner Apply agile principles to avoid the self-creation of inherently risky or uncertain situations Apply agile principles to avoid the harm (be robust) and reap the benefits (be antifragile) from uncertainty in the environment Manage risk via the product backlog
  • 6.
    6Copyright © 2014,Innolution, LLC. All Rights Reserved. Uncertain Events
  • 7.
    7 Many words forthe same concept Copyright © 2014, Innolution, LLC. All Rights Reserved. Risk Randomness Volatility Variability Uncertainty
  • 8.
    8 For our purposeswe will treat them the same Copyright © 2014, Innolution, LLC. All Rights Reserved. Lack of knowledge regarding uncertain events
  • 9.
    9 Some more uncertainevents Copyright © 2014, Innolution, LLC. All Rights Reserved. Earthquake disables California data center housing the development servers Vendor fails to deliver a component when promised Application fails to scale to 10 million current usersUsers
  • 10.
    10Copyright © 2014,Innolution, LLC. All Rights Reserved. Typical mental model of uncertain events “Uncertain” event Probability of occurrence Consequence (payoff / exposure function) Impact of occurrence sum of all has a has Cost Candidate action Effectiveness has has changes changes 1..* Can influence 1..* 1..* Expected monetary value used to compute used to compute Source: Based on paper by Jerry Gilland, Engineering Management Services, 1996.
  • 11.
    11Copyright © 2014,Innolution, LLC. All Rights Reserved. Maximize Expected Monetary Value
  • 12.
    12 We strive tomaximize economic benefit Copyright © 2014, Innolution, LLC. All Rights Reserved. “Uncertain” event Probability of occurrence Consequence (payoff / exposure function) Impact of occurrence sum of all has a has Cost Candidate action Effectiveness has has changes changes 1..* Can influence 1..* 1..* Expected monetary value used to compute used to compute Our goal is to maximize the “economic benefit” in the presence of uncertainty Given that uncertain events will occur…
  • 13.
    13 Fragile, Robust, Antifragile Copyright© 2014, Innolution, LLC. All Rights Reserved. Fragile Harmed by disorder Robust Resilient to disorder Antifragile Benefits from disorder Agile Goal is not to eliminate uncertainty, risk, or variability, but to protect ourselves against the variability that harms us and to promote and exploit the variability that benefits us Waterfall
  • 14.
    14 Asymmetric payoffs create economicvalue or harm Copyright © 2014, Innolution, LLC. All Rights Reserved. Positive asymmetric payoff (antifragile) anything that has more upside than downside from random events (variability) Negative asymmetric payoff (fragile) anything that has more downside than upside from random events (variability) Source: Taleb, Nassim, Antifragile: Things That Gain from Disorder, Random House, 2012.
  • 15.
    15Copyright © 2014,Innolution, LLC. All Rights Reserved. Traditional Risk Management
  • 16.
  • 17.
    17 Example traditional risk- managementartifacts Copyright © 2014, Innolution, LLC. All Rights Reserved. Risk Prob Exposure Mitigation 0 20 40 60 80 100 0% 10% 20% 30% 40% 50% Cost($K) Probability % 1 2 3 4 5 6 7 8 9 10 Risk Management Plan
  • 18.
    18 Assumption – earlyon we can identify the uncertain events Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 19.
    19 Assumption – wecan identify all uncertain events Copyright © 2014, Innolution, LLC. All Rights Reserved. Large-scale unpredictable (or very hard to predict) events of massive consequences Source: Taleb, Nassim, The Black Swan: The Impact of the Highly Improbable Fragility , Random House, 2010.
  • 20.
    20Copyright © 2007-2014,Innolution, LLC. All Rights Reserved. Assumption — we can accurately calculate probabilities 0 20 40 60 80 100 0% 10% 20% 30% 40% 50% Cost($K) Probability % 1 2 3 4 5 6 7 8 9 10 Assumes we can predict the probabilities
  • 21.
    21 Example – wecan predict the event, but we can’t predict or change probabilities Copyright © 2014, Innolution, LLC. All Rights Reserved. We can predict earthquakes will happen in California We can’t predict the occurrence of a specific earthquake of a given magnitude, or change the probability of it happening We can describe the consequences to our business via a disruption in our California-based data center if we are affected by an earthquake
  • 22.
    22 More sophisticated processdoes NOT solve these problems Copyright © 2014, Innolution, LLC. All Rights Reserved. Mistaken belief that we need better computation in order to more accurately predict the event and figure out the probabilities Better approach is to modify our exposure and learn to get out of trouble fast
  • 23.
    23 So, do weemploy traditional risk management in Agile? Copyright © 2014, Innolution, LLC. All Rights Reserved. Like anything else in Agile, we would embrace the minimum (barely sufficient) amount of process that would be sufficient for dealing with the risks in our particular environment Domains where human lives are at risk might choose to employ a more intense risk management process
  • 24.
    24 Example of asimple risk Copyright © 2014, Innolution, LLC. All Rights Reserved. Vendor might fail to deliver a component on a promised date “Uncertain” event Probability of occurrence Consequence (payoff / exposure function) Impact of occurrence sum of all has a has Cost Candidate action Effectiveness has has changes changes 1..* Can influence 1..* 1..* Expected monetary value used to compute used to compute We can easily identify the uncertain event We can derive a probability that isn’t too wrong There are easily identifiable candidate actions The consequences are well understood
  • 25.
    25 Candidate action 1– traditional risk management Copyright © 2014, Innolution, LLC. All Rights Reserved. Send one or more of our employees to vendor to help expedite Risk Prob Exposure Mitigation Vendor fails to deliver Component X 50% $1m/month Send Barbara to vendor to help expedite Manage risk via lightweight traditional techniques
  • 26.
    26 Candidate action 2– also traditional risk management Copyright © 2014, Innolution, LLC. All Rights Reserved. Pay expedited charge to move to head of queue Risk Prob Exposure Mitigation Vendor fails to deliver Component X 50% $1m/month Pay more money to get head of queue privileges Manage risk via lightweight traditional techniques
  • 27.
    27Copyright © 2014,Innolution, LLC. All Rights Reserved. Managing Risk via the Product Backlog
  • 28.
    28Copyright © 2007-2014,Innolution, LLC. All Rights Reserved. Value Cost Dependencies Knowledge Risk Resources Risk as a factor in prioritization
  • 29.
    29 Example: Develop emailsystem for 10 million concurrent users Copyright © 2014, Innolution, LLC. All Rights Reserved. Option 1 Option 2 Spend a lot of money early on to develop core and advanced email features Then, perform scale-up testing late and hope it works Run tests earlier to determine if scaling to 10m users is possible Then, start building email features with confidence system will scale up to 10m users
  • 30.
    30 Manage dependency riskvia product backlog grooming Copyright © 2014, Innolution, LLC. All Rights Reserved. Affects prioritization of other items in the product backlog This feature is dependent on delivery of the component Vendor might fail to deliver a component on a promised date
  • 31.
    31 Manage risk bycreating risk- mitigation items in product backlog Copyright © 2014, Innolution, LLC. All Rights Reserved. Employ the parallel hedge strategy Us Insert one or more product backlog items to develop the component ourselves First to finish wins! Partner
  • 32.
    32Copyright © 2014,Innolution, LLC. All Rights Reserved. Using Agile to Avoid Some Uncertain Situations
  • 33.
    33 Some uncertain eventscan be avoided altogether Copyright © 2014, Innolution, LLC. All Rights Reserved. Avoid the self-creation of inherently risky or uncertain situations If we don’t go into space, we don’t have to worry about the risk that our spaceship could run out of fuel Fixed FixedFixed Contract If we don’t write fixed price subcontracts, we can avoid the risks of fixed price contracts!
  • 34.
    34Copyright © 2014,Innolution, LLC. All Rights Reserved. Effort saved not having to “manage” uncertain events “Uncertain” event Probability of occurrence Consequence (payoff / exposure function) Impact of occurrence sum of all has a has Cost Candidate action Effectiveness has has changes changes 1..* Can influence 1..* 1..* Expected monetary value used to compute used to compute Think of the effort saved if we end up injecting less uncertain events into our environment!!! The art of maximizing the amount of work not done!
  • 35.
    35Copyright © 2014,Innolution, LLC. All Rights Reserved. Exercise – identifying uncertain events avoidable by Agile What are some known risks or uncertainties that we can avoid just by applying Agile development?
  • 36.
    36Copyright © 2014,Innolution, LLC. All Rights Reserved. Agile Principle- based Risk Management
  • 37.
    37 Applying agile principlesto be robust and antifragile Copyright © 2014, Innolution, LLC. All Rights Reserved. Applying agile principles make the development process robust and at times antifragile to the disorder of uncertain events, allowing us to avoid harm and reap the benefits of uncertainty, without the need for heavyweight risk management processes
  • 38.
    38Copyright © 2014,Innolution, LLC. All Rights Reserved. Failure to Apply Scrum Principles Throughout the Value Chain Variability and Uncertainty
  • 39.
    39Copyright © 2014,Innolution, LLC. All Rights Reserved. All before any is “risk generating” All-Before-Any: assumes all” of one activity can be completed before any of the next activity begins
  • 40.
    40 Iterative & incrementalis antifragile Copyright © 2014, Innolution, LLC. All Rights Reserved. Get things wrong before we get them right Build some of it before we build all of it Reduces forecasting errors Offers opportunity for continuous deployment
  • 41.
    41 Inspect and adaptis antifragile Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 42.
    42Copyright © 2014,Innolution, LLC. All Rights Reserved. Failure to Apply Scrum Principles Throughout the Value Chain Prediction and Adaptation
  • 43.
    43 Risk of tryingto get it right upfront Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 44.
    44 Keep options open (lastresponsible moment) Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 45.
    45 Exercise – ArchitectureA vs. B Copyright © 2014, Innolution, LLC. All Rights Reserved. First day of a new product development effort. There are two architectural choices: A or B. Each appears to have viable characteristics. Which one should we select?
  • 46.
    46 Rapidly intermingle explorationand exploitation to address uncertainty Copyright © 2014, Innolution, LLC. All Rights Reserved. Knowledge acquisition Predicting Exploration Exploitation always a tension between requiresinvolves in the presence of UncertaintyUncertainty in the presence of increases Level of certainty does not increase Adaptive processes Predictive processes heavily focus on early interleave small-scale
  • 47.
    47 Real options Copyright ©2014, Innolution, LLC. All Rights Reserved. The right but not the obligation to do something Options have value Options expire Never commit early to an option unless we know why
  • 48.
    48 Managing change riskduring a traditional development project Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 49.
    49 Managing change riskusing Scrum Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 50.
    50Copyright © 2014,Innolution, LLC. All Rights Reserved. Failure to Apply Scrum Principles Throughout the Value Chain Validated Learning
  • 51.
    51 Assumptions = accruedrisk Copyright © 2014, Innolution, LLC. All Rights Reserved. Assumption is a guess or belief that is assumed true, real, or certain Not-yet-validated assumptions represent significant accrued risk during development Don’t let important assumptions live long without validation
  • 52.
    52 Reduce risk bygoing fast through the loop Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 53.
    53 Organize flow ofwork for fast feedback Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 54.
    54 Fast feedback isantifragile Copyright © 2014, Innolution, LLC. All Rights Reserved. Agile benefits from the uncertainty (unpredictable things we learn) in fast, frequent feedback Learn fast we are going down the wrong path and then truncate the path Exploit newly acquired knowledge to realize an emergent opportunity Asymmetric payoff by limiting downside harm and providing much greater upside potential
  • 55.
    55Copyright © 2014,Innolution, LLC. All Rights Reserved. Failure to Apply Scrum Principles Throughout the Value Chain Work in Process (WIP)
  • 56.
    56 Use economically sensible (typicallysmaller) batch sizes Copyright © 2014, Innolution, LLC. All Rights Reserved. Reduced cycle time Reduced flow variability Accelerated feedback Lower risk of failure Reduced overhead Increased motivation & urgency Reduced cost and schedule growth Source: Reinertsen, Donald, The Principles of Product Development Flow: Second Generation Lean Product Development, Celeritas Publishing, 2009.
  • 57.
    57 Inventory (WIP) representsa significant economic risk Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 58.
    58Copyright © 2014,Innolution, LLC. All Rights Reserved. Failure to Apply Scrum Principles Throughout the Value Chain Planning Risks
  • 59.
    59 Belief that loadingplanning on the front-end reduces risk Copyright © 2014, Innolution, LLC. All Rights Reserved. Better the planning the better the understanding and therefore the better the execution Give appearance of orderly, accountable, and predictable approach Developing a product rarely goes as planned Beliefs don’t match uncertainty in product development
  • 60.
    60 Scope is therisk-reducing degree of freedom Copyright © 2014, Innolution, LLC. All Rights Reserved. Scope can be binary Scope can be shades of grey Allows us to bound the downside on the asymmetric payoff function
  • 61.
    61 Communicate uncertainty with rangeanswers to questions Copyright © 2014, Innolution, LLC. All Rights Reserved.
  • 62.
    62 Teams with T-Shapedskills Copyright © 2014, Innolution, LLC. All Rights Reserved. Can offset random increases in demand by quickly compensating with changes in capacity Example of negative covariance or counter balancing. Changing capacity available to do work a given vertical area (a change in one random variable) counterbalances the variability in demand (a change in a second random variable)
  • 63.
    63Copyright © 2014,Innolution, LLC. All Rights Reserved. Contact Info for Ken Rubin Email: krubin@innolution.com Website: www.innolution.com Phone: (303) 827-3333 LinkedIn: www.linkedin.com/in/kennethrubin Twitter: www.twitter.com/krubinagile Facebook: www.facebook.com/InnolutionLLC Google+ plus.google.com/+KennyRubin1/ Essential Scrum: A Practical Guide to the Most Popular Agile Process www.essentialscrum.com Comparative Agility Website www.comparativeagility.com
