Progress Report
Quarterly
Review – Q3
Nov 2014
Prepared by Ernest CHAN
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A

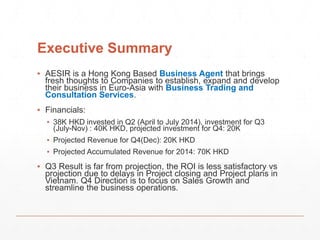

Executive Summary
▪ AESIR is a Hong Kong Based Business Agent that brings
fresh thoughts to Companies to establish, expand and develop
their business in Euro-Asia with Business Trading and
Consultation Services.
▪ Financials:
▪ 38K HKD invested in Q2 (April to July 2014), investment for Q3
(July-Nov) : 40K HKD, projected investment for Q4: 20K
▪ Projected Revenue for Q4(Dec): 20K HKD
▪ Projected Accumulated Revenue for 2014: 70K HKD
▪ Q3 Result is far from projection, the ROI is less satisfactory vs
projection due to delays in Project closing and Project plans in
Vietnam. Q4 Direction is to focus on Sales Growth and
streamline the business operations.
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A
ABOUT AESIR
AESIR stands for
Æsir : [ey-sir, ey-zir] Scandinavian Mythology. the principal race of gods, led by Odin. In love of
Scandinavian Culture, AESIR represents a working of Fine Asia – Europe Exchange Offer,
replacing previous 洋行.
Exclusive Distributor for Indonesian Sidikalang Garden & Vietnam Dat Lat Speciality Coffee in
Greater China (獨家代理印尼和越南兩地的精品高原咖啡特別推薦野生貓屎咖啡)
Vietnam Omyiage (Elegant Pastry Gifts from Vietnam) for Tourists
eCommerce with European design, localized function to engage Target Customers via online
communities.
Coffee
Trading
Supply
Chain
Sales &
Marketing
E&E
Coffe
e
Vietnam Omyiage
IT
eCommerce
Social
Media
Design
ABOUT US
WHY AESIR
▪ Key Drive: Euro ≤ ≥ Asia Trading = 639+922 US Billion
Asia
▪ With China-ASEAN Free Trade Zone 中國─東盟自由貿易區active
since 2010 on Brunei, Indonesia, Malaysia, the Philippines,
Singapore and Thailand, in 2015 will apply to remaining ASEAN
members. The biggest Free Trade Zone in terms of population and
third in terms of Value is expected to grow further despite the
economic slowdown in Europe & America.
Asia-Europe
▪ China is the EU's biggest source of imports by far, and has also
become one of the EU's fastest growing export markets. The EU
has also become China’s biggest source of imports.
▪ China and Europe now trade well over €1 billion a day.
AESIR LIMITED
▪ Offer Value Adding Services (Brand & Marketing, Distribution,
Channeling, Business Consultation) to Euro-Asia Business in
Expansion.
ABOUT US
AESIR stands for
Vision
A Well Connected World for a Better Future
Mission
Enjoyment in
Working
Excellence in
Quality
Control
Earnest to
our
stakeholders
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A
Our Team
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A

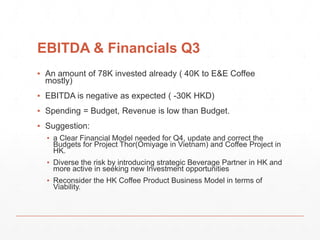

EBITDA & Financials Q3
▪ An amount of 78K invested already ( 40K to E&E Coffee
mostly)
▪ EBITDA is negative as expected ( -30K HKD)
▪ Spending = Budget, Revenue is low than Budget.
▪ Suggestion:
▪ a Clear Financial Model needed for Q4, update and correct the
Budgets for Project Thor(Omiyage in Vietnam) and Coffee Project in
HK.
▪ Diverse the risk by introducing strategic Beverage Partner in HK and
more active in seeking new Investment opportunities
▪ Reconsider the HK Coffee Product Business Model in terms of
Viability.
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A
Project Review-
Coffee in Vietnam Hong Kong
▪ Investment Request: 150K HKD
▪ Payback Period: 11months
▪ ROI: 47%
▪ Market Opportunities Brief:
Coffee Consumption Market in Greater China is
expected to grow 2.5 times in 2020 vs 2012.
From 2012Q1 to 2013 Q3, China Demand on
Coffee has already reached 25%.
Offering Coffee Product as Pilot Entry would give
AESIR a strong Premium Brand Image.
According to Euromonitor, Coffee represents
premium beverage category as a high standard
of living, opening doors for AESIR to premium
markets.
Operation Strategy
Due to legal concern and better financial
management, AESIR Limited plays the role as
Supply Unit for Indonesian and Vietnam Coffee
Providers to China Markets, E&E will be a
customer brand with over 51% Ownerships by
AESIR Management team.
E&E investment:
Marketing: 20K
Sales Support: 50K
HR: 60K
Total: 130K HKD
Coffee
Trading
Supply
Chain
Sales &
Marketing
E&E
Coffe
e
Progress & Achievement
▪ Packaging
▪ POS
▪ Magazine Metropop
▪ Events:
LiveNorish Blogger, Convoy fin Coffee
tasting
3 Business Models:
▪ Green Bean to Yuen Long Coffee Roaster
▪ Gift Set to Retailer Stores
▪ Coffee Bean & Powder with Tools
Sales Channel
China: Art Studio ( on hold)
HK: Consignment in Food Store, Uskitchen
Short lease Market
Resources Needed
▪ Investment Capital: 80K HKD less
▪ Packaging Specification and Communication needed in
Vietnam & Indonesia
▪ Transport Logistics concern on MOQ, Dimensions and
Shipment Dates
▪ Warehouse Storage and Owned Sales Channel
▪ Sales Channel Expansion
▪ Strategic Partners / Alliances on F&B sector
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A
Project Review Omiyage
▪ Investment Request: 60K HKD
▪ Payback Period: 14 months
▪ ROI: 40%
▪ Market Opportunities Brief:
Scope: Premium Handy Food Souvenirs
Strategic Reason: 1st Investment Project from
AESIR to secure overseas earnings with high
growth potential with limited capital raised to
examine the right move on Market SEA.
Product Concept : Handy Food Souvenir
exchange custom in far East. Viet Nam lacks a
strong Food Brand appealing to Tourists to
represent VN.
Main Characteristics :
Handy Food with mini 2 Weeks expiration
Unique & Appealing package that represents
Vietnam
Green: Recyclable, Reusable
▪ Sales Channel: Tourists store & Cafe, Travel
agency, Cooperate Gifts
▪ Key roles: Ernest Chan, Hung Tran
▪ Supply unit: VN Bakery Hy Goodies to be locked
in Late May.
▪ Investment:
Development cost: 10K
Food Cost & Package Cost: 15K
Production equipment: 20K
Marketing: 5K
Others : 10K
TOTAL : 60K
Payback : 14 months

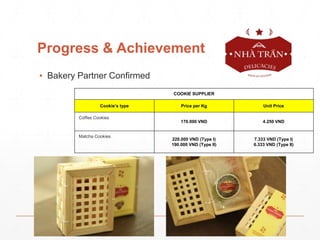

Progress & Achievement
▪ Bakery Partner Confirmed
COOKIE SUPPLIER
Cookie’s type Price per Kg Unit Price
Coffee Cookies
170.000 VND 4.250 VND
Matcha Cookies
220.000 VND (Type I)
190.000 VND (Type II)
7.333 VND (Type I)
6.333 VND (Type II)
Resources Needed
▪ Sales & operations Strategy Refinement
▪ Food Licensing & Food Safety
▪ Logistics Partner
▪ Operations Model
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q3
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q4 & Year 2014
7. Endorsement
8. Q&A

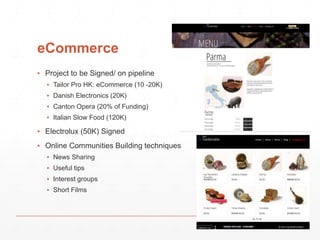

eCommerce
▪ Project to be Signed/ on pipeline
▪ Tailor Pro HK: eCommerce (10 -20K)
▪ Danish Electronics (20K)
▪ Canton Opera (20% of Funding)
▪ Italian Slow Food (120K)
▪ Electrolux (50K) Signed
▪ Online Communities Building techniques
▪ News Sharing
▪ Useful tips
▪ Interest groups
▪ Short Films

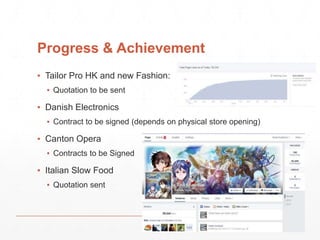

Progress & Achievement
▪ Tailor Pro HK and new Fashion:
▪ Quotation to be sent
▪ Danish Electronics
▪ Contract to be signed (depends on physical store opening)
▪ Canton Opera
▪ Contracts to be Signed
▪ Italian Slow Food
▪ Quotation sent

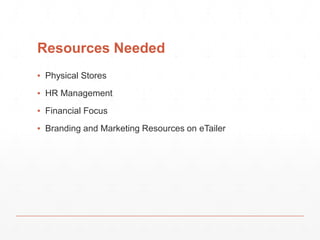

Resources Needed
▪ Physical Stores
▪ HR Management
▪ Financial Focus
▪ Branding and Marketing Resources on eTailer
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q2
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q3 & Year 2014
7. Endorsement
8. Q&A

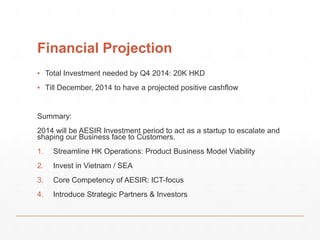

Financial Projection
▪ Total Investment needed by Q4 2014: 20K HKD
▪ Till December, 2014 to have a projected positive cashflow
Summary:
2014 will be AESIR Investment period to act as a startup to escalate and
shaping our Business face to Customers.
1. Streamline HK Operations: Product Business Model Viability
2. Invest in Vietnam / SEA
3. Core Competency of AESIR: ICT-focus
4. Introduce Strategic Partners & Investors
AGENDA
AESIR, your Business Agent in Euro-Asia
1. Executive Summary
2. About AESIR
3. Our Team
4. EBITDA & Financials Q2
5. Project Reviews
a) Coffee Trading in Vietnam & Hong Kong
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
b) Omiyage (Food Souvenir in Vietnam)
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
c) eCommerce
i. Investment Request
ii. Progress & Achievement
iii. Resources needed
6. Financial Projection Q3 & Year 2014
7. Endorsement
8. Q&A
Endorsement
AESIR LIMITED
“AESIR Team is a task-focused shaper…. Always
organized in work and is able to effectively multi-task
to ensure that all projects completed…..”
Electrolux AB Small Appliances (Sweden)
Our Customers:
“We are more than happy to partner with
AESIR to rebrand our products with a set
of Marketing Campaigns.”
Traditional Sidikalang Coffee Garden (Indonesia)
New Initiatives
ICT 2015
Foodertainment
AR Wearing
Augment Reality Applications
Foodertainme
nt
To bring in tradition and values behind the food
Fun for Food
Video
Awarenss:
Drawing
Shoppers to the
store location
with iBeacon
Consideration:
With Augment
reality posters to
get Foodies
consider the
food items
Conversion:
with iBeacon to
enable shoppers
pay at Point of
Sales
Loyalty: Auto
record purchase
record so to
cusomtize foodie
information
Advocacy:
Forming a
cooking class
community to
showcase how
cuisine made.
Support Foodies Eating Journey with
iBeacon & Augment Reality
Business Model
First 4th Month
AR Motion
Recipe
Marketing
apps
End of 6th Month
Package
display on
food
ingredients
and
labeling
Post 6th Month
iBeacon on
Retail
experience
Potential
Customers 海生隆發記
識別
時尚
AR Wearing
Wear Your Game With Augment Reality
Video
Business Model in 6 Month
First 3 months
AR Tech
on
Wearing
simulation
By end of 6th Month
Kigurumi
theme AR
Games.
Post 6 Months
AR Motion
Games
with
wearing
technology
Business
Partners
www.gentlemens.sk
Zìzài Kù – Sverige
Nordic Asian Pop Fashion
Webshop
Demo
Q&A

AESIR LIMITED Q3 report

  • 1.
    Progress Report Quarterly Review – Q3 Nov 2014 Prepared by Ernest CHAN
  • 2.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 3.
    Executive Summary ▪AESIR is a Hong Kong Based Business Agent that brings fresh thoughts to Companies to establish, expand and develop their business in Euro-Asia with Business Trading and Consultation Services. ▪ Financials: ▪ 38K HKD invested in Q2 (April to July 2014), investment for Q3 (July-Nov) : 40K HKD, projected investment for Q4: 20K ▪ Projected Revenue for Q4(Dec): 20K HKD ▪ Projected Accumulated Revenue for 2014: 70K HKD ▪ Q3 Result is far from projection, the ROI is less satisfactory vs projection due to delays in Project closing and Project plans in Vietnam. Q4 Direction is to focus on Sales Growth and streamline the business operations.
  • 4.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 5.
    ABOUT AESIR AESIRstands for Æsir : [ey-sir, ey-zir] Scandinavian Mythology. the principal race of gods, led by Odin. In love of Scandinavian Culture, AESIR represents a working of Fine Asia – Europe Exchange Offer, replacing previous 洋行. Exclusive Distributor for Indonesian Sidikalang Garden & Vietnam Dat Lat Speciality Coffee in Greater China (獨家代理印尼和越南兩地的精品高原咖啡特別推薦野生貓屎咖啡) Vietnam Omyiage (Elegant Pastry Gifts from Vietnam) for Tourists eCommerce with European design, localized function to engage Target Customers via online communities. Coffee Trading Supply Chain Sales & Marketing E&E Coffe e Vietnam Omyiage IT eCommerce Social Media Design
  • 6.
    ABOUT US WHYAESIR ▪ Key Drive: Euro ≤ ≥ Asia Trading = 639+922 US Billion Asia ▪ With China-ASEAN Free Trade Zone 中國─東盟自由貿易區active since 2010 on Brunei, Indonesia, Malaysia, the Philippines, Singapore and Thailand, in 2015 will apply to remaining ASEAN members. The biggest Free Trade Zone in terms of population and third in terms of Value is expected to grow further despite the economic slowdown in Europe & America. Asia-Europe ▪ China is the EU's biggest source of imports by far, and has also become one of the EU's fastest growing export markets. The EU has also become China’s biggest source of imports. ▪ China and Europe now trade well over €1 billion a day. AESIR LIMITED ▪ Offer Value Adding Services (Brand & Marketing, Distribution, Channeling, Business Consultation) to Euro-Asia Business in Expansion.
  • 7.
    ABOUT US AESIRstands for Vision A Well Connected World for a Better Future Mission Enjoyment in Working Excellence in Quality Control Earnest to our stakeholders
  • 8.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 9.
  • 10.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 11.
    EBITDA & FinancialsQ3 ▪ An amount of 78K invested already ( 40K to E&E Coffee mostly) ▪ EBITDA is negative as expected ( -30K HKD) ▪ Spending = Budget, Revenue is low than Budget. ▪ Suggestion: ▪ a Clear Financial Model needed for Q4, update and correct the Budgets for Project Thor(Omiyage in Vietnam) and Coffee Project in HK. ▪ Diverse the risk by introducing strategic Beverage Partner in HK and more active in seeking new Investment opportunities ▪ Reconsider the HK Coffee Product Business Model in terms of Viability.
  • 12.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 13.
    Project Review- Coffeein Vietnam Hong Kong ▪ Investment Request: 150K HKD ▪ Payback Period: 11months ▪ ROI: 47% ▪ Market Opportunities Brief: Coffee Consumption Market in Greater China is expected to grow 2.5 times in 2020 vs 2012. From 2012Q1 to 2013 Q3, China Demand on Coffee has already reached 25%. Offering Coffee Product as Pilot Entry would give AESIR a strong Premium Brand Image. According to Euromonitor, Coffee represents premium beverage category as a high standard of living, opening doors for AESIR to premium markets. Operation Strategy Due to legal concern and better financial management, AESIR Limited plays the role as Supply Unit for Indonesian and Vietnam Coffee Providers to China Markets, E&E will be a customer brand with over 51% Ownerships by AESIR Management team. E&E investment: Marketing: 20K Sales Support: 50K HR: 60K Total: 130K HKD Coffee Trading Supply Chain Sales & Marketing E&E Coffe e
  • 14.
    Progress & Achievement ▪ Packaging ▪ POS ▪ Magazine Metropop ▪ Events: LiveNorish Blogger, Convoy fin Coffee tasting 3 Business Models: ▪ Green Bean to Yuen Long Coffee Roaster ▪ Gift Set to Retailer Stores ▪ Coffee Bean & Powder with Tools Sales Channel China: Art Studio ( on hold) HK: Consignment in Food Store, Uskitchen Short lease Market
  • 15.
    Resources Needed ▪Investment Capital: 80K HKD less ▪ Packaging Specification and Communication needed in Vietnam & Indonesia ▪ Transport Logistics concern on MOQ, Dimensions and Shipment Dates ▪ Warehouse Storage and Owned Sales Channel ▪ Sales Channel Expansion ▪ Strategic Partners / Alliances on F&B sector
  • 16.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 17.
    Project Review Omiyage ▪ Investment Request: 60K HKD ▪ Payback Period: 14 months ▪ ROI: 40% ▪ Market Opportunities Brief: Scope: Premium Handy Food Souvenirs Strategic Reason: 1st Investment Project from AESIR to secure overseas earnings with high growth potential with limited capital raised to examine the right move on Market SEA. Product Concept : Handy Food Souvenir exchange custom in far East. Viet Nam lacks a strong Food Brand appealing to Tourists to represent VN. Main Characteristics : Handy Food with mini 2 Weeks expiration Unique & Appealing package that represents Vietnam Green: Recyclable, Reusable ▪ Sales Channel: Tourists store & Cafe, Travel agency, Cooperate Gifts ▪ Key roles: Ernest Chan, Hung Tran ▪ Supply unit: VN Bakery Hy Goodies to be locked in Late May. ▪ Investment: Development cost: 10K Food Cost & Package Cost: 15K Production equipment: 20K Marketing: 5K Others : 10K TOTAL : 60K Payback : 14 months
  • 18.
    Progress & Achievement ▪ Bakery Partner Confirmed COOKIE SUPPLIER Cookie’s type Price per Kg Unit Price Coffee Cookies 170.000 VND 4.250 VND Matcha Cookies 220.000 VND (Type I) 190.000 VND (Type II) 7.333 VND (Type I) 6.333 VND (Type II)
  • 19.
    Resources Needed ▪Sales & operations Strategy Refinement ▪ Food Licensing & Food Safety ▪ Logistics Partner ▪ Operations Model
  • 20.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q3 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q4 & Year 2014 7. Endorsement 8. Q&A
  • 21.
    eCommerce ▪ Projectto be Signed/ on pipeline ▪ Tailor Pro HK: eCommerce (10 -20K) ▪ Danish Electronics (20K) ▪ Canton Opera (20% of Funding) ▪ Italian Slow Food (120K) ▪ Electrolux (50K) Signed ▪ Online Communities Building techniques ▪ News Sharing ▪ Useful tips ▪ Interest groups ▪ Short Films
  • 22.
    Progress & Achievement ▪ Tailor Pro HK and new Fashion: ▪ Quotation to be sent ▪ Danish Electronics ▪ Contract to be signed (depends on physical store opening) ▪ Canton Opera ▪ Contracts to be Signed ▪ Italian Slow Food ▪ Quotation sent
  • 23.
    Resources Needed ▪Physical Stores ▪ HR Management ▪ Financial Focus ▪ Branding and Marketing Resources on eTailer
  • 24.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q2 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q3 & Year 2014 7. Endorsement 8. Q&A
  • 25.
    Financial Projection ▪Total Investment needed by Q4 2014: 20K HKD ▪ Till December, 2014 to have a projected positive cashflow Summary: 2014 will be AESIR Investment period to act as a startup to escalate and shaping our Business face to Customers. 1. Streamline HK Operations: Product Business Model Viability 2. Invest in Vietnam / SEA 3. Core Competency of AESIR: ICT-focus 4. Introduce Strategic Partners & Investors
  • 26.
    AGENDA AESIR, yourBusiness Agent in Euro-Asia 1. Executive Summary 2. About AESIR 3. Our Team 4. EBITDA & Financials Q2 5. Project Reviews a) Coffee Trading in Vietnam & Hong Kong i. Investment Request ii. Progress & Achievement iii. Resources needed b) Omiyage (Food Souvenir in Vietnam) i. Investment Request ii. Progress & Achievement iii. Resources needed c) eCommerce i. Investment Request ii. Progress & Achievement iii. Resources needed 6. Financial Projection Q3 & Year 2014 7. Endorsement 8. Q&A
  • 27.
    Endorsement AESIR LIMITED “AESIR Team is a task-focused shaper…. Always organized in work and is able to effectively multi-task to ensure that all projects completed…..” Electrolux AB Small Appliances (Sweden) Our Customers: “We are more than happy to partner with AESIR to rebrand our products with a set of Marketing Campaigns.” Traditional Sidikalang Coffee Garden (Indonesia)
  • 28.
  • 29.
    Foodertainment AR Wearing Augment Reality Applications
  • 30.
    Foodertainme nt Tobring in tradition and values behind the food Fun for Food
  • 31.
    Video Awarenss: Drawing Shoppers to the store location with iBeacon Consideration: With Augment reality posters to get Foodies consider the food items Conversion: with iBeacon to enable shoppers pay at Point of Sales Loyalty: Auto record purchase record so to cusomtize foodie information Advocacy: Forming a cooking class community to showcase how cuisine made. Support Foodies Eating Journey with iBeacon & Augment Reality
  • 33.
    Business Model First4th Month AR Motion Recipe Marketing apps End of 6th Month Package display on food ingredients and labeling Post 6th Month iBeacon on Retail experience Potential Customers 海生隆發記
  • 37.
    識別 時尚 ARWearing Wear Your Game With Augment Reality
  • 38.
  • 39.
    Business Model in6 Month First 3 months AR Tech on Wearing simulation By end of 6th Month Kigurumi theme AR Games. Post 6 Months AR Motion Games with wearing technology Business Partners www.gentlemens.sk Zìzài Kù – Sverige Nordic Asian Pop Fashion Webshop
  • 40.
  • 41.
