SlideShare a Scribd company logo
THE NEXT GREAT UNDERGROUND
MINE IN CANADA
Corporate Presentation
RBC Mining’s Rising Stars – August 2017
WWW.FALCORES.COM | FPC:TSXV
Disclaimer
This presentation contains a review of the Company’s properties in Canada. Viewers are cautioned that the projects are at an early stage of exploration and that estimates and projections
contained herein are based on limited and incomplete data. More work is required before the mineralization on the projects and their economic aspects can be confidentaly modeled.
Therefore, the work results and estimates herein may be considered to be generally indicative only of the nature and quality of the projects. No representation or prediction is intended as to
the results of future work, nor can there be any promise that the estimates herein will be confirmed by future exploration or analysis, or that the projects will otherwise prove to be
economic.
The TSX Venture Exchange has not reviewed and does not accept responsibility for the accuracy or adequacy of this presentation, which has been prepared by management. There can be
no assurance that any of the assumptions in the resource estimates will be supported by a Pre-feasibility or Feasibility Study or that any forward looking event will come to pass. The data is
incomplete and considerable additional work will be required to complete further evaluation, including but not limited to drilling, engineering and socio-economic studies and investment.
Past performance is no guarantee of future performance and all investors are urged to consult their investment professionals before making an investment decision. Investors are further
cautioned that past performance is no guarantee of future performance
Forward-Looking Statements
Certain information included in this presentation constitutes forward-looking statements, including any information as to our projects, plans and future performance. All statements, other
than statements of historical fact, are forward-looking statements. The words “expect”, “believe”, “anticipate”, “will”, “intend”, “estimate”, “forecast”, “budget”, “schedule” and similar
expressions identify forward-looking statements. Forward-looking statements are necessarily based upon a number of factors and assumptions that, while considered reasonable by
management, are inherently subject to significant business, economic and competitive uncertainties and contingencies. Known and unknown factors could cause actual results to differ
materially from those projected in the forward-looking statements.
Such factors include, but are not limited to: changes to current estimates of mineral resources; labour availability; litigation; availability of and increased costs associated with contractors
and exploration equipment; the speculative nature of mineral exploration and development, including the risks of obtaining necessary licenses and permits; contests over title to properties;
uncertainty with the Company’s ability to secure capital to execute its business plans; changes in national and local government legislation in Canada; risk of loss due to sabotage and civil
disturbances; risks arising from holding derivative instruments; and business opportunities that may be pursued by the Company. Many of these uncertainties and contingencies can affect
our actual results and could cause actual results to differ materially from those expressed or implied in any forward-looking statements made by, or on behalf of, us. Readers are cautioned
that forward-looking statements are not guarantees of future performance.
The Company disclaims any intention or obligation to update or revise any forward-looking statements whether as a result of new information, future events or otherwise, except as
required by applicable law.
Cautionary Note to U.S Investors Concerning Measured, Indicated and Inferred Resources
This presentation uses the terms “measured,” “indicated” and “inferred resources. We advise investors that while those terms are recognized and required by Canadian regulations, the
United States Securities and Exchange commission does not recognize them. Under Canadian rules, estimates of inferred mineral resources may not form the basis of feasibility or other
economic studies. United States investors are cautioned not to assume that all or any part of measured or indicated mineral resources will ever be converted into mineral reserves. United
States investors are also cautioned not to assume that all or any part of an inferred mineral resource exists, or is economically or legally mineable.
CAUTIONARY STATEMENT
TSXV: FPC | WWW.FALCORES.COM | 3
TSXV:FPC
C$192M
MARKET CAP
~C$46.2M
CASH & CASH EQUIVALENTS
7.1 Moz AuEq M&I
TOTAL RESOURCES
1.7 Moz AuEq Inferred
TOTAL RESOURCES
236,000 GOLD OZ
ESTIMATED AVERAGE GOLD
ANNUAL PRODUCTION
US$427 PER GOLD OZ
ALL-IN SUSTAINING COST
US$680M
DEVELOPMENT CAPITAL EXPENDITURE
>12 YEARS
INITIAL MINE LIFE
TSXV: FPC | WWW.FALCORES.COM | 4

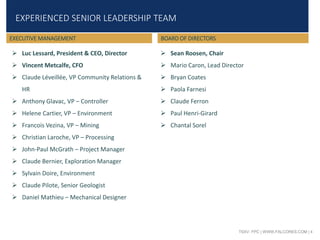

EXPERIENCED SENIOR LEADERSHIP TEAM
 Luc Lessard, President & CEO, Director
 Vincent Metcalfe, CFO
 Claude Léveillée, VP Community Relations &
HR
 Anthony Glavac, VP – Controller
 Helene Cartier, VP – Environment
 Francois Vezina, VP – Mining
 Christian Laroche, VP – Processing
 John-Paul McGrath – Project Manager
 Claude Bernier, Exploration Manager
 Sylvain Doire, Environment
 Claude Pilote, Senior Geologist
 Daniel Mathieu – Mechanical Designer
EXECUTIVE MANAGEMENT BOARD OF DIRECTORS
 Sean Roosen, Chair
 Mario Caron, Lead Director
 Bryan Coates
 Paola Farnesi
 Claude Ferron
 Paul Henri-Girard
 Chantal Sorel
TSXV: FPC | WWW.FALCORES.COM | 5
CAPITAL SUMMARY & SHAREHOLDER REGISTRY
SHAREHOLDER REGISTRY
Osisko Gold Royalties 13.2%
Tocqueville 9.2%
Investissement Quebec 5.2%
Oppenheimer Funds 2.0%
Old Mutual 1.6%
RBIM 1.1%
CIBC Asset Management 1.0%
Caisse de Depot du Quebec 1.0%
Shares Outstanding (basic) 179,644,768
Stock Options 9,151,736
Warrants 28,281,717
Shares Outstanding (fully diluted) 205,934,721
Share Price C$1.07
Market Capitalization C$192.2
Cash Position ~C$42.6 Million
CAPITAL STRUCTURE (AS OF AUG 15, 2017)
Source: Factset, Bloomberg, public filings and Company estimates
TSXV: FPC | WWW.FALCORES.COM | 6

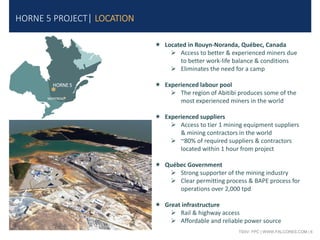

HORNE 5 PROJECT| LOCATION
 Located in Rouyn-Noranda, Québec, Canada
 Access to better & experienced miners due
to better work-life balance & conditions
 Eliminates the need for a camp
 Experienced labour pool
 The region of Abitibi produces some of the
most experienced miners in the world
 Experienced suppliers
 Access to tier 1 mining equipment suppliers
& mining contractors in the world
 ~80% of required suppliers & contractors
located within 1 hour from project
 Québec Government
 Strong supporter of the mining industry
 Clear permitting process & BAPE process for
operations over 2,000 tpd
 Great infrastructure
 Rail & highway access
 Affordable and reliable power source
HORNE 5
MONTREAL
TSXV: FPC | WWW.FALCORES.COM | 7

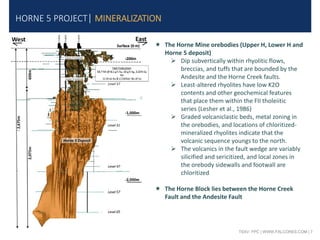

HORNE 5 PROJECT| MINERALIZATION
 The Horne Mine orebodies (Upper H, Lower H and
Horne 5 deposit)
 Dip subvertically within rhyolitic flows,
breccias, and tuffs that are bounded by the
Andesite and the Horne Creek faults.
 Least-altered rhyolites have low K2O
contents and other geochemical features
that place them within the FII tholeiitic
series (Lesher et al., 1986)
 Graded volcaniclastic beds, metal zoning in
the orebodies, and locations of chloritized-
mineralized rhyolites indicate that the
volcanic sequence youngs to the north.
 The volcanics in the fault wedge are variably
silicified and sericitized, and local zones in
the orebody sidewalls and footwall are
chloritized
 The Horne Block lies between the Horne Creek
Fault and the Andesite Fault
TSXV: FPC | WWW.FALCORES.COM | 8
HIGH GRADE ZONES

HORNE 5 PROJECT| LONG & CROSS SECTIONS OF THE DEPOSIT
MINERAL ENVELOPS
MEASURED & INDICATED + INFERRED (at C$55 NSR cut-off)
Resource
Class
Tonnes Au Equivalent
g/t
Au
g/t
Ag
g/t
Cu
%
Zn
%
Contained Au
EQ (mm oz)
Contained Au
(mm oz)
Contained Ag
(oz)
Contained Cu
(mm lbs)
Contained Zn
(mm lbs)
Measured 9.4 2.45 1.58 16.33 0.18 0.81 736 475 4,914 37.7 167.4
Indicated 81.7 2.41 1.56 14.19 0.18 0.86 6,336 4,088 37,295 315.8 1,552.7
Total M&I 91.1 2.41 1.56 14.41 0.18 0.86 7,072 4,564 42,209 353.5 1,720.1
Inferred 22.3 2.39 1.47 22.98 0.20 0.68 1,710 1,053 16,463 99.2 336.1
TSXV: FPC | WWW.FALCORES.COM | 9

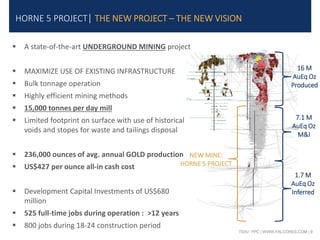

HORNE 5 PROJECT| THE NEW PROJECT – THE NEW VISION
 A state-of-the-art UNDERGROUND MINING project
 MAXIMIZE USE OF EXISTING INFRASTRUCTURE
 Bulk tonnage operation
 Highly efficient mining methods
 15,000 tonnes per day mill
 Limited footprint on surface with use of historical
voids and stopes for waste and tailings disposal
 236,000 ounces of avg. annual GOLD production
 US$427 per ounce all-in cash cost
 Development Capital Investments of US$680
million
 525 full-time jobs during operation : >12 years
 800 jobs during 18-24 construction period
NEW MINE:
HORNE 5 PROJECT
16 M
AuEq Oz
Produced
7.1 M
AuEq Oz
M&I
1.7 M
AuEq Oz
Inferred
TSXV: FPC | WWW.FALCORES.COM | 10

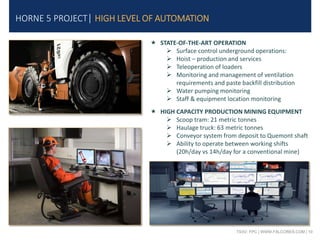

HORNE 5 PROJECT| HIGH LEVEL OF AUTOMATION
 STATE-OF-THE-ART OPERATION
 Surface control underground operations:
 Hoist – production and services
 Teleoperation of loaders
 Monitoring and management of ventilation
requirements and paste backfill distribution
 Water pumping monitoring
 Staff & equipment location monitoring
 HIGH CAPACITY PRODUCTION MINING EQUIPMENT
 Scoop tram: 21 metric tonnes
 Haulage truck: 63 metric tonnes
 Conveyor system from deposit to Quemont shaft
 Ability to operate between working shifts
(20h/day vs 14h/day for a conventional mine)
TSXV: FPC | WWW.FALCORES.COM | 11

HORNE 5 PROJECT| MINING APPROACH FOR FEASIBILITY >17 YEARS OF LIFE
 EXISTING SHAFT
TSXV: FPC | WWW.FALCORES.COM | 12
Project Potash Corp
Ukraine KJRK
Phase 1
Ukraine KJRK
Phase 2
Horne 5
Phase 1
Horne 5
Phase 2
Depth (m) 1,200 1,340 1,800 1,200 1,800
Speed (m/s) 18-20 19 19 18 18
Operating Hours 19-20 22 22 19 19
Skip capacity (t) 40-65 50 50 43 39.4
Productivity
(tpd)
25,000-30,000 22,050 17,640 23,200 16,550
HORNE 5 PROJECT| HOISTING COMPARABLES
43T SKIP – Similar to Horne 5 Sizing

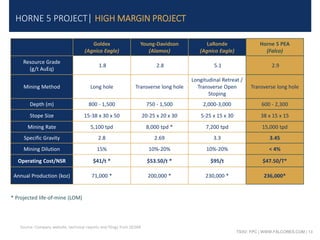

TSXV: FPC | WWW.FALCORES.COM | 13
Goldex
(Agnico Eagle)
Young-Davidson
(Alamos)
LaRonde
(Agnico Eagle)
Horne 5 PEA
(Falco)
Resource Grade
(g/t AuEq)
1.8 2.8 5.1 2.9
Mining Method Long hole Transverse long hole
Longitudinal Retreat /
Transverse Open
Stoping
Transverse long hole
Depth (m) 800 - 1,500 750 - 1,500 2,000-3,000 600 - 2,300
Stope Size 15-38 x 30 x 50 20-25 x 20 x 30 5-25 x 15 x 30 38 x 15 x 15
Mining Rate 5,100 tpd 8,000 tpd * 7,200 tpd 15,000 tpd
Specific Gravity 2.8 2.69 3.3 3.45
Mining Dilution 15% 10%-20% 10%-20% < 4%
Operating Cost/NSR $41/t * $53.50/t * $95/t $47.50/T*
Annual Production (koz) 71,000 * 200,000 * 230,000 * 236,000*
* Projected life-of-mine (LOM)
Source: Company website, technical reports and filings from SEDAR
HORNE 5 PROJECT| HIGH MARGIN PROJECT
TSXV: FPC | WWW.FALCORES.COM | 14

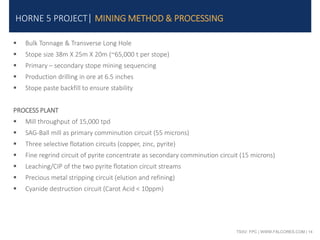

HORNE 5 PROJECT| MINING METHOD & PROCESSING
 Bulk Tonnage & Transverse Long Hole
 Stope size 38m X 25m X 20m (~65,000 t per stope)
 Primary – secondary stope mining sequencing
 Production drilling in ore at 6.5 inches
 Stope paste backfill to ensure stability
PROCESS PLANT
 Mill throughput of 15,000 tpd
 SAG-Ball mill as primary comminution circuit (55 microns)
 Three selective flotation circuits (copper, zinc, pyrite)
 Fine regrind circuit of pyrite concentrate as secondary comminution circuit (15 microns)
 Leaching/CIP of the two pyrite flotation circuit streams
 Precious metal stripping circuit (elution and refining)
 Cyanide destruction circuit (Carot Acid < 10ppm)
TSXV: FPC | WWW.FALCORES.COM | 15

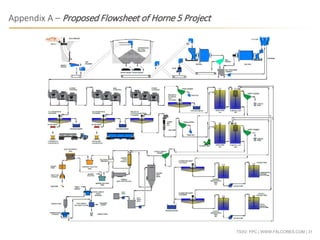

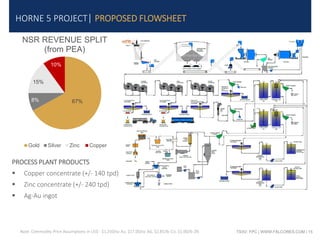

HORNE 5 PROJECT| PROPOSED FLOWSHEET
67%8%
15%
10%
NSR REVENUE SPLIT
(from PEA)
Gold Silver Zinc Copper
Note: Commodity Price Assumptions in US$ - $1,250/oz Au, $17.00/oz AG, $2.85/lb CU, $1.00/lb ZN
PROCESS PLANT PRODUCTS
 Copper concentrate (+/- 140 tpd)
 Zinc concentrate (+/- 240 tpd)
 Ag-Au ingot
TSXV: FPC | WWW.FALCORES.COM | 16
HORNE 5 PROJECT| DEVELOPMENT CAPITAL EXPENDITURES US$680M
$186
$265
$16
$74
$14
$82
$45
Mining
Processing Plant
Electrical and Communication
Site Infrastructure
Tailings and Water Management
Indirects
Contingency
TOTAL
PRE-PRODUCTION
CAPITAL COSTS
US$680M
Note: Amounts may vary due to rounding.
*FROM PEA
TSXV: FPC | WWW.FALCORES.COM | 17

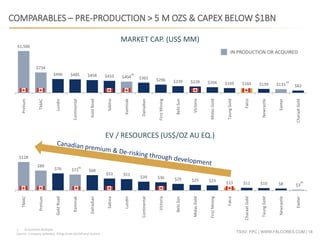

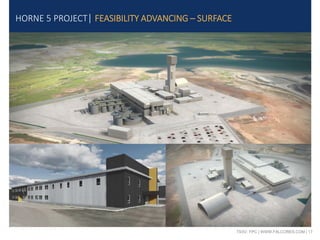

HORNE 5 PROJECT| FEASIBILITY ADVANCING – SURFACE
TSXV: FPC | WWW.FALCORES.COM | 18

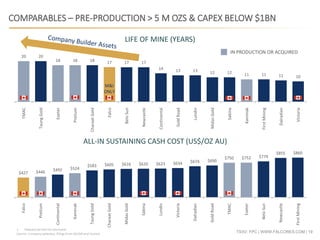

$13
$128
$89
$71
$3
$76 $68
$53 $51
$39 $36 $29 $25 $23
$11 $10 $8
TMAC
Pretium
GoldRoad
Kaminak
Dalradian
Sabina
Lundin
Continental
Victoria
BeloSun
MidasGold
FirstMining
Falco
CharaatGold
TaungGold
Newcastle
Exeter
(1)
(1)
EV / RESOURCES (US$/OZ AU EQ.)
$164
$1,506
$734
$404
$133
$496 $485 $458 $433 $365 $296 $239 $228 $204 $169 $139 $83
Pretium
TMAC
Lundin
Continental
GoldRoad
Sabina
Kaminak
Dalradian
FirstMining
BeloSun
Victoria
MidasGold
TaungGold
Falco
Newcastle
Exeter
CharaatGold
(1)
(1)
MARKET CAP. (US$ MM)
COMPARABLES – PRE-PRODUCTION > 5 M OZS & CAPEX BELOW $1BN
IN PRODUCTION OR ACQUIRED
1. Acquisition Multiple
Source: Company websites, filings from SEDAR and Factset
TSXV: FPC | WWW.FALCORES.COM | 19
ALL-IN SUSTAINING CASH COST (US$/OZ AU)
$427 $446
$524
$750 $752
$492
$583 $605 $616 $620 $623 $634 $674 $690
$779
$855 $860
Falco
Pretium
Continental
Kaminak
TaungGold
CharaatGold
MidasGold
Sabina
Lundin
Victoria
Dalradian
GoldRoad
TMAC
Exeter
BeloSun
Newcastle
FirstMining
17
20
18 18
11
20
18 17 17
14 13 13 12 12 11 11 10
TMAC
TaungGold
Exeter
Pretium
CharaatGold
Falco
BeloSun
Newcastle
Continental
GoldRoad
Lundin
MidasGold
Sabina
Kaminak
FirstMining
Dalradian
Victoria
LIFE OF MINE (YEARS)
COMPARABLES – PRE-PRODUCTION > 5 M OZS & CAPEX BELOW $1BN
1. Payback period not disclosed.
Source: Company websites, filings from SEDAR and Factset
IN PRODUCTION OR ACQUIRED
M&I
ONLY
TSXV: FPC | WWW.FALCORES.COM | 20

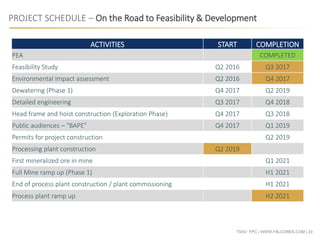

PROJECT SCHEDULE – On the Road to Feasibility & Development
ACTIVITIES START COMPLETION
PEA COMPLETED
Feasibility Study Q2 2016 Q3 2017
Environmental Impact assessment Q2 2016 Q4 2017
Dewatering (Phase 1) Q4 2017 Q2 2019
Detailed engineering Q3 2017 Q4 2018
Head frame and hoist construction (Exploration Phase) Q4 2017 Q3 2018
Public audiences – “BAPE” Q4 2017 Q1 2019
Permits for project construction Q2 2019
Processing plant construction Q2 2019
First mineralized ore in mine Q1 2021
Full Mine ramp up (Phase 1) H1 2021
End of process plant construction / plant commissioning H1 2021
Process plant ramp up H2 2021
TSXV: FPC | WWW.FALCORES.COM | 21

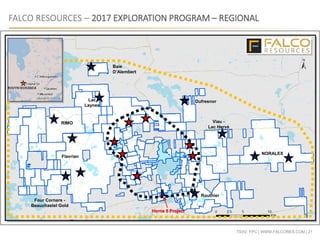

FALCO RESOURCES – 2017 EXPLORATION PROGRAM – REGIONAL
RIMO
Lac
Laynes
Routhier
NORALEX
Dufresnor
Baie
D’Alembert
Four Corners -
Beauchastel Gold
Viau -
Lac Hervé
Horne 5 Project
Flavrian
TSXV: FPC | WWW.FALCORES.COM | 22
Head Office
Falco Resources Ltd.
1100, avenue des
Canadiens-de-Montréal
Bureau 300
Montréal, QC H3B 2S2
Tél. : +1.514.905.3162
Toll Free : +1.888.915.2009
Courriel : info@falcores.com
Investor Inquiries
Vincent Metcalfe, CFO
Tel: +1.514.905.3162
Email: vmetcalfe@falcores.com
CONTACT US
TSXV: FPC | WWW.FALCORES.COM | 23
APPENDIX
Appendix A – PEA Additional Information
Appendix B – Resource & Modeling Notes
Appendix C – Research Coverage
TSXV: FPC | WWW.FALCORES.COM | 24

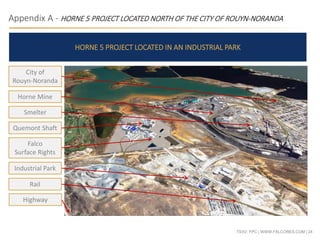

Appendix A - HORNE 5 PROJECT LOCATED NORTH OF THE CITY OF ROUYN-NORANDA
HORNE 5 PROJECT LOCATED IN AN INDUSTRIAL PARK
City of
Rouyn-Noranda
Smelter
Horne Mine
Quemont Shaft
Falco
Surface Rights
Industrial Park
Rail
Highway
TSXV: FPC | WWW.FALCORES.COM | 25
Appendix A – @ C$55NSR
Note: Commodity Price Assumptions in US$ - $1,300/oz Au, $18.50/oz AG, $2.15/lb CU, $1.00/lb ZN
Resource
Class
Cut-off
(NSR C$)
Tonnes Au Equivalent
g/t
Au
g/t
Ag
g/t
Cu
%
Zn
%
Contained Au
EQ
(oz)
Contained Au
(oz)
Contained Ag
(oz)
Contained Cu
(lbs)
Contained Zn
(lbs)
> 40 112,837,300 2.19 1.40 13.51 0.16 0.77 7,933,432 5,092,093 49,006,097 404,004,013 1,918,532,372
> 45 105,660,800 2.26 1.45 13.80 0.17 0.80 7,675,704 4,934,128 46,895,548 388,219,896 1,861,812,513
> 50 98,431,300 2.34 1.50 14.10 0.17 0.83 7,389,520 4,758,936 44,630,965 371,415,421 1,795,554,378
> 55 91,096,800 2.41 1.56 14.41 0.18 0.86 7,072,273 4,563,793 42,209,208 353,502,913 1,720,132,089
> 60 83,674,500 2.50 1.62 14.74 0.18 0.89 6,724,071 4,348,340 39,658,845 334,697,744 1,635,170,900
> 65 76,164,000 2.59 1.68 15.10 0.19 0.92 6,343,817 4,114,360 36,964,321 314,464,092 1,538,362,827
> 70 68,857,000 2.69 1.75 15.44 0.19 0.94 5,946,460 3,872,056 34,187,862 293,539,891 1,433,144,432
> 75 61,768,900 2.79 1.82 15.78 0.20 0.97 5,534,345 3,622,782 31,338,658 272,412,325 1,319,587,642
> 80 55,205,800 2.89 1.90 16.07 0.21 0.99 5,128,157 3,379,201 28,514,569 252,090,038 1,204,136,268
> 85 48,979,500 3.00 1.99 16.32 0.22 1.01 4,719,916 3,133,727 25,694,362 232,283,780 1,087,297,243
> 90 43,127,300 3.11 2.08 16.53 0.22 1.02 4,314,767 2,889,443 22,920,820 212,895,273 971,164,640
> 95 37,708,700 3.23 2.19 16.76 0.23 1.03 3,920,117 2,649,110 20,318,763 194,147,093 859,000,393
> 100 32,847,800 3.36 2.29 16.93 0.24 1.04 3,547,992 2,423,233 17,878,830 176,525,171 751,901,217
Resource
Class
Cut-off
(NSR C$)
Tonnes Au Equivalent
g/t
Au
g/t
Ag
g/t
Cu
%
Zn
%
Contained Au
EQ
(oz)
Contained Au
(oz)
Contained Ag
(oz)
Contained Cu
(lbs)
Contained Zn
(lbs)
> 40 29,982,700 2.09 1.27 20.20 0.18 0.62 2,018,308 1,225,760 19,474,995 121,579,421 408,634,980
> 45 27,554,500 2.18 1.33 21.03 0.19 0.64 1,930,445 1,176,117 18,634,351 114,786,950 389,104,374
> 50 24,940,000 2.28 1.39 21.98 0.20 0.66 1,826,125 1,116,815 17,622,512 107,406,534 365,167,423
> 55 22,283,200 2.39 1.47 22.98 0.20 0.68 1,709,902 1,053,061 16,463,471 99,171,805 336,101,668
> 60 20,058,400 2.49 1.54 23.94 0.21 0.70 1,604,361 995,491 15,437,436 91,439,498 309,347,419
> 65 17,472,900 2.62 1.64 25.21 0.21 0.72 1,472,114 922,946 14,159,498 80,661,116 278,551,219
> 70 15,293,600 2.75 1.74 26.48 0.21 0.74 1,352,929 856,634 13,019,250 71,823,610 249,906,179
> 75 13,406,500 2.88 1.84 27.70 0.22 0.75 1,242,755 794,507 11,940,661 64,601,999 222,924,808
> 80 11,528,900 3.04 1.96 29.10 0.23 0.77 1,126,483 727,514 10,784,724 57,409,881 195,709,438
> 85 9,821,100 3.21 2.11 30.25 0.23 0.78 1,014,192 664,774 9,552,769 50,654,094 168,612,199
> 90 8,222,900 3.41 2.29 30.98 0.25 0.77 902,741 604,603 8,189,164 44,700,861 139,977,418
> 95 6,927,000 3.63 2.48 31.57 0.26 0.76 807,727 552,850 7,030,524 39,678,474 115,974,677
> 100 5,912,700 3.84 2.68 32.15 0.27 0.74 729,660 509,966 6,112,206 35,554,367 96,081,089
Inferred
Measured
+
Indicated
TSXV: FPC | WWW.FALCORES.COM | 26

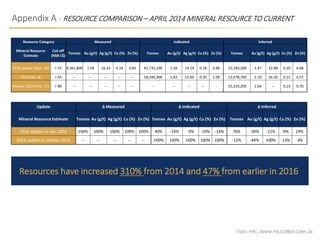

Appendix A - RESOURCE COMPARISON – APRIL 2014 MINERAL RESOURCE TO CURRENT
Resource Category Measured Indicated Inferred
Mineral Resource
Estimate
Cut-off
(NSR C$)
Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%)
2016 update (Sept. 26) > 55 9,361,800 1.58 16.33 0.18 0.81 81,735,100 1.56 14.19 0.18 0.86 22,283,200 1.47 22.98 0.20 0.68
2016 (Jan. 8) > 65 -- -- -- -- -- 58,346,300 1.82 15.60 0.20 1.00 12,678,700 2.10 26.26 0.22 0.57
Maiden 2014 (Feb. 17) > 80 -- -- -- -- -- -- -- -- -- -- 25,319,200 2.64 -- 0.23 0.70
Update ∆ Measured ∆ Indicated ∆ Inferred
Mineral Resource Estimate Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%)
2016 update vs. Jan. 2016 100% 100% 100% 100% 100% 40% -14% -9% -10% -14% 76% -30% -12% -9% 19%
2016 update vs. Maiden 2014 -- -- -- -- -- 100% 100% 100% 100% 100% -12% -44% 100% -13% -3%
Resources have increased 310% from 2014 and 47% from earlier in 2016
TSXV: FPC | WWW.FALCORES.COM | 27

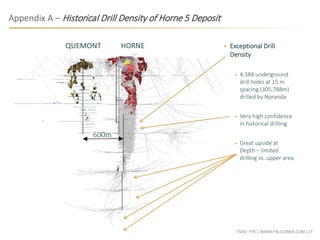

Appendix A – Historical Drill Density of Horne 5 Deposit
600m
HORNEQUEMONT  Exceptional Drill
Density
 4,384 underground
drill holes at 15 m
spacing (305,788m)
drilled by Noranda
 Very high confidence
in historical drilling
 Great upside at
Depth – limited
drilling vs. upper area
TSXV: FPC | WWW.FALCORES.COM | 28
Appendix A – Horne 5 Deposit & 2015 Confirmation Drilling Program
HORNEQUEMONT
TSXV: FPC | WWW.FALCORES.COM | 29

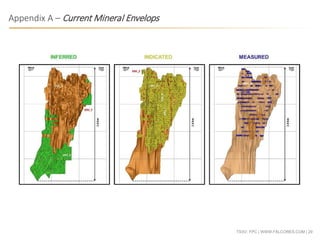

Appendix A – Current Mineral Envelops
TSXV: FPC | WWW.FALCORES.COM | 30
• NPV of $1.131 billion at a 5% discount rate and an IRR of 20.0% before taxes and mining duties
• NPV of $667 million at a 5% discount rate and an IRR of 16.0% after taxes and mining duties
• Peak-year production of 274 kozs and average LOM annual production of 236 kozs of gold
• Net payable gold recovery of 86.8%
• 3,051,000 gold ounces production at an average diluted grade of 2.60 g/t Au LOM
• 2,903,000 ounces of payable gold LOM
• 807 million pounds of payable zinc LOM
• 194 million pounds of payable copper LOM
• 23.8 million ounces of payable silver LOM
• All-in sustaining costs* of US$427 PER PAYABLE GOLD OUNCE
• All-in cost (CAPEX plus OPEX) is estimated at US$660 per payable gold ounce
• Initial CAPEX of C$905 million (including a $60 million contingency) or US$680 million
• Payback Period of 3.8 years pre-tax and 4.1 years post-tax
• Gross Revenue of $6.8 billion and Operating Cash-flow of $2.6 billion
• Start of production in 2020
• Full production in 2021
• Initial mine life of 12 years
*All-in Sustaining Costs are presented as defined by the World Gold Council ("WGC") less Corporate G&A
Note: Commodity Price Assumptions in US$ - $1,250/oz Au, $17.00/oz AG, $2.85/lb CU, $1.00/lb ZN
Appendix A – Horne 5 Project Key Highlights
TSXV: FPC | WWW.FALCORES.COM | 31
Appendix A – Proposed Flowsheet of Horne 5 Project
TSXV: FPC | WWW.FALCORES.COM | 32
PROCESSING | SAG & Ball Mill with Cyclone Cluster
TSXV: FPC | WWW.FALCORES.COM | 33
PROCESSING | Overall Flotation Tank
TSXV: FPC | WWW.FALCORES.COM | 34
PROCESSING | Regrind Mill
TSXV: FPC | WWW.FALCORES.COM | 35
PROCESSING | Carbon in Pulp
TSXV: FPC | WWW.FALCORES.COM | 36
Source: Wood Mackenzie Ltd. And BMO Capital Markets
* All-in Sustaining Costs are presented as defined by the World Gold Council ("WGC") less Corporate G&A
$0
$500
$1,000
$1,500
$2,000
$2,500
2016 Gold Mine, Composite, Total Cash + Sustaining Capex Cost
Grouped By Mine and Ranked By Total Cash plus Sustaining Capex
TotalCash+SustainingCapex(US$/oz)
0 500 1000 1500 2000
Paid Gold (t)
Horne 5 Project AISC of US$427/oz

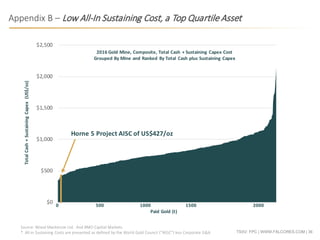

Appendix B – Low All-In Sustaining Cost, a Top Quartile Asset
TSXV: FPC | WWW.FALCORES.COM | 37

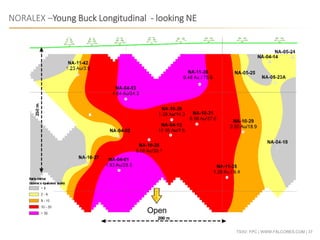

NORALEX –Young Buck Longitudinal - looking NE
Open
TSXV: FPC | WWW.FALCORES.COM | 38

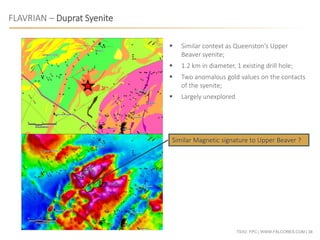

FLAVRIAN – Duprat Syenite
Similar Magnetic signature to Upper Beaver ?
 Similar context as Queenston’s Upper
Beaver syenite;
 1.2 km in diameter, 1 existing drill hole;
 Two anomalous gold values on the contacts
of the syenite;
 Largely unexplored
TSXV: FPC | WWW.FALCORES.COM | 39
CENTRAL CAMP – West Ansil – 1.7 KM of Ansil
Inmont
New Insco
Bouchard-Hebert
Horne
Ansil
Gallen
Aldermac
Corbet
Millenbach
0 5 km
Montbray
Norbec
Delbridge
Amulet A-CWaite
DEPOSIT Mt %Cu %Zn Opt Au
Horne (H-G-E) 54.0 2.20 0.18
Quemont 15.0 1.22 1.90 0.12
Bouchard-Hebert lens 1100 10.2 0.72 5.39 0.04
Amulet Lower A 5.2 5.10 5.20 0.04
Norbec 4.3 2.77 4.70 0.02
Millenbach 3.5 3.50 4.50 0.03
Gallen 3.3 0.07 4.77 0.02
Corbet 2.7 2.90 2.00 0.03
East Waite 1.7 4.10 3.25 0.05
Ansil 1.4 7.18 0.80 0.06
Old Waite 1.2 4.70 2.98 0.03
New Insco (Not mined) 1.2 2.11 0.03
Delbridge 0.4 0.55 8.60 0.07

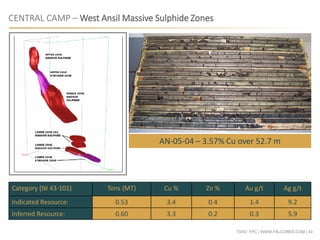

TSXV: FPC | WWW.FALCORES.COM | 40
CENTRAL CAMP – West Ansil Massive Sulphide Zones
Category (NI 43-101) Tons (MT) Cu % Zn % Au g/t Ag g/t
Indicated Resource: 0.53 3.4 0.4 1.4 9.2
Inferred Resource: 0.60 3.3 0.2 0.3 5.9
AN-05-04 – 3.57% Cu over 52.7 m
TSXV: FPC | WWW.FALCORES.COM | 41
Appendix B – Mineral Resource Estimates & Modeling Notes
1. The effective date of the resource estimate is September 26, 2016. The Independent and Qualified Persons for the Mineral Resource Estimate as required by National Instrument 43-101
are Carl Pelletier, P. Geo., B.Sc. and Guilhem Servelle, P.Geo., M.Sc., both employees of InnovExplo Inc.
2. Mineral Resources are not Mineral Reserves and have not demonstrated economic viability.
3. While the results are presented undiluted and in situ, the reported mineral resources are considered by the Qualified Persons to have reasonable prospects for economic extraction.
4. These estimates include six (6) low grade gold-bearing mineralized zones.
5. The principal low-grade gold-bearing mineralized zone includes six (6) high-grade gold-bearing zones, one (1) high-grade copper-bearing zone, one (1) high grade zinc-bearing zone, three (3)
high-grade silver-bearing zones. Note that these high-grade zones may overlap each other.
6. Resources were compiled at NSR cut-offs of C$40, C$45, C$50, C$55, C$60, C$65, C$70, C$75, C$80, C$85, C$90, C$95, and C$100 per tonne for sensitivity purposes.
7. The official base case resource is reported at a C$55 per tonne NSR cut-off.
8. The appropriate NSR cut-off will vary depending on prevailing economic and operational parameters to be determined.
9. NSR estimates are based on the following assumptions: exchange rate of $C1.30/$US, metal prices of (all $US): gold $1,300/oz, silver $18.50, copper $2.15/lb, zinc $1.00/lb (Long term
analyst consensus price forecast study). Net recoveries of 86.8% for gold, 74.9% for silver, 67.3% for zinc and 74.0% for copper. Smelting cost (including transportation) C$6.52 per tonne (based
on the Cost Mine service as well as on non-public smelter contract obtained from one of the proposed destinations and on talks with transport providers).
10. Gold equivalent calculations assume these same metal prices.
11. Inferred resources are separate from Indicated Resources
12. The quantity and grade of reported Inferred Resources in this estimate are uncertain in nature and there has not been sufficient work to define these Inferred Resources as Indicated or
Measured Resources. It is uncertain if further work will result in upgrading them to an Indicated or Measured mineral resource category.
13. The resource was estimated using Geovia GEMS 6.7. The estimate is based on 5,977 diamond drill holes (478,281m) of which 4,138 crosscut mineralized zones for a total of 177,996m of core
within these zones. For silver the estimate also uses the results of an exhaustive metallurgical test comprising 2,112 diamond drill holes assayed for silver over a total length of 75,540 meters. A
minimum true thickness of 7.0 m was applied, using the grade of the adjacent material when assayed, or a value of zero when not assayed. Only the silver interpolation in the Inferred resources
does not use the material when not assayed.
14. The estimate database contains also 14,799 channel samples for a total of 23,791m from drifts historically sampled. Channel sample data was only used for distance to composite criterion for
resource classification purposes.
15. 91% of density values were estimated using historical drill hole iron assays data and Falco density data for an average of 3.41 g/cm3. Interpolation method use 3 pass ID2 for the ENV_A and HG_A
to HG_F zones. 8% of density values were fixed at 2.88 g/cm3 for ENV_B to ENV_E zones due to the scarcity of the data. 2.88 g/cm3 representing the median of the available data. 1% of density
values were fixed at 2.67 g/cm3 for ENV_F zone due to the scarcity of the date and to adequately characterise this quartz-rich zone.
16. Compositing was done on drill hole sections falling within the mineralized zones (composite = 3.0 metres). Tails shorter than 0.75 m were not created.
17. Resources were evaluated from drill holes using an ID2 interpolation method in a block model (block size = 5 x 5 x 5 m).
18. High grade capping was done on raw assay data and established on a per zone basis for gold (Au g/t): (HG_A: 35; HG_B: 35; HG_C: 25; HG_D: 35; HG_E: 25; HG_F: 35; ENV_A: 35; ENV_B: 25;
ENV_C: 25; ENV_D: 20; ENV_E: 35; ENV_F: 25) and for silver (Ag g/t): SG_HG:100; HG_D: 165; HG_F: 165; ENV_A_SG_Low: 110; ENV_B: 100; ENV_C: 100; ENV_D: 100. Capping grade selection is
supported by statistical analysis. No capping was applied to the Cu and Zn data based on statistical analysis.
19. The Mineral Resources presented herein are categorized as Measured, Indicated and Inferred. The Inferred category is only defined within the areas where blocks were interpolated during pass
1 or pass 2 in areas where continuity is sufficient to avoid isolated blocks. The Indicated category is only defined by blocks interpolated in areas where the maximum distance to the closest drill
hole composite is less than 25m for blocks interpolated in passes 1 and 2. The Measured category is only defined by blocks classified as indicated and in sufficient proximity to sampled drifts (<
15m). The average distance to the nearest composite is 6.97 meters for the Measured resources, 10.01 meters for the Indicated resources and 40.10 meters for the Inferred resources.
20. Tonnage estimates were rounded to the nearest hundred tonnes. Any discrepancies in the totals are due to rounding effects. Rounding practice follows the recommendations set out in Form 43-
101F1.
21. CIM definitions and guidelines were followed in estimating mineral resources.
22. InnovExplo is not aware of any known environmental, permitting, legal, title-related, taxation, socio-political, marketing or other relevant issue that could materially affect the mineral resource
estimate.
23. Metal contained in ounces (troy) = metric tonnes x grade / 31.10348. Calculations used metric units (metres, tonnes and g/t). Metal contents are presented in ounces and pounds .
RESOURCE ESTIMATE NOTES

More Related Content

What's hot

Corporate Presentation - November 2015
Corporate Presentation - November 2015Corporate Presentation - November 2015
Corporate Presentation - November 2015Adnet Communications

2015 Investor Presentation - Vancouver
2015 Investor Presentation - Vancouver2015 Investor Presentation - Vancouver
2015 Investor Presentation - VancouverFalcoCorporate

12.6 2016 investor presentation
12.6 2016 investor presentation12.6 2016 investor presentation
12.6 2016 investor presentationFalcoCorporate

August Investor presentation
August Investor presentationAugust Investor presentation
August Investor presentationFalcoCorporate

Cascada updated corporate presentation september 2021
Cascada updated corporate presentation september 2021Cascada updated corporate presentation september 2021
Cascada updated corporate presentation september 2021ZhalaRahim

GoldQuest Corporate Presentation - October 2015
GoldQuest Corporate Presentation - October 2015GoldQuest Corporate Presentation - October 2015
GoldQuest Corporate Presentation - October 2015GoldQuest Mining Corp.

Cascada updated corporate presentation july 2021
Cascada updated corporate presentation july 2021Cascada updated corporate presentation july 2021
Cascada updated corporate presentation july 2021ZhalaRahim

Thesis Gold November 2021 Company Presentation
Thesis Gold November 2021 Company PresentationThesis Gold November 2021 Company Presentation
Thesis Gold November 2021 Company PresentationThe Howard Group Inc.

NOVAGOLD 2016 First Quarter Financials & Project Update
NOVAGOLD 2016 First Quarter Financials & Project UpdateNOVAGOLD 2016 First Quarter Financials & Project Update
NOVAGOLD 2016 First Quarter Financials & Project UpdateNOVAGOLD

Millrock Presentation - Fall 2021
Millrock Presentation - Fall 2021Millrock Presentation - Fall 2021
Millrock Presentation - Fall 2021Millrock Resources

Thesis Gold October 2021 Investor Deck
Thesis Gold October 2021 Investor DeckThesis Gold October 2021 Investor Deck
Thesis Gold October 2021 Investor DeckThe Howard Group Inc.

Corporate presentation-june-30-2016
Corporate presentation-june-30-2016Corporate presentation-june-30-2016
Corporate presentation-june-30-2016Adnet Communications

October pp 2021 short
October pp 2021 shortOctober pp 2021 short
October pp 2021 shortAdnetNew

Secova Metals (SEK.v) Corporate Presentation
Secova Metals (SEK.v) Corporate PresentationSecova Metals (SEK.v) Corporate Presentation
Secova Metals (SEK.v) Corporate PresentationMomentumPR

Precious metals summit 2019, beaver creek
Precious metals summit 2019, beaver creekPrecious metals summit 2019, beaver creek
Precious metals summit 2019, beaver creekProbe Gold

Silver One Resources Corporate Presentation September 2021
Silver One Resources Corporate Presentation September 2021Silver One Resources Corporate Presentation September 2021
Silver One Resources Corporate Presentation September 2021Adnet Communications

Peterdavies 140303205825-phpapp01
Peterdavies 140303205825-phpapp01Peterdavies 140303205825-phpapp01
Peterdavies 140303205825-phpapp01ImageRes

What's hot (20)

Corporate Presentation - November 2015
Corporate Presentation - November 2015Corporate Presentation - November 2015
Corporate Presentation - November 2015

2015 Investor Presentation - Vancouver
2015 Investor Presentation - Vancouver2015 Investor Presentation - Vancouver
2015 Investor Presentation - Vancouver

12.6 2016 investor presentation
12.6 2016 investor presentation12.6 2016 investor presentation
12.6 2016 investor presentation

August Investor presentation
August Investor presentationAugust Investor presentation
August Investor presentation

Cascada updated corporate presentation september 2021
Cascada updated corporate presentation september 2021Cascada updated corporate presentation september 2021
Cascada updated corporate presentation september 2021

GoldQuest Corporate Presentation - October 2015
GoldQuest Corporate Presentation - October 2015GoldQuest Corporate Presentation - October 2015
GoldQuest Corporate Presentation - October 2015

Cascada updated corporate presentation july 2021
Cascada updated corporate presentation july 2021Cascada updated corporate presentation july 2021
Cascada updated corporate presentation july 2021

Thesis Gold November 2021 Company Presentation
Thesis Gold November 2021 Company PresentationThesis Gold November 2021 Company Presentation
Thesis Gold November 2021 Company Presentation

NOVAGOLD 2016 First Quarter Financials & Project Update
NOVAGOLD 2016 First Quarter Financials & Project UpdateNOVAGOLD 2016 First Quarter Financials & Project Update
NOVAGOLD 2016 First Quarter Financials & Project Update

Millrock Presentation - Fall 2021
Millrock Presentation - Fall 2021Millrock Presentation - Fall 2021
Millrock Presentation - Fall 2021

Thesis Gold October 2021 Investor Deck
Thesis Gold October 2021 Investor DeckThesis Gold October 2021 Investor Deck
Thesis Gold October 2021 Investor Deck

Corporate presentation-june-30-2016
Corporate presentation-june-30-2016Corporate presentation-june-30-2016
Corporate presentation-june-30-2016

October pp 2021 short
October pp 2021 shortOctober pp 2021 short
October pp 2021 short

Secova Metals (SEK.v) Corporate Presentation
Secova Metals (SEK.v) Corporate PresentationSecova Metals (SEK.v) Corporate Presentation
Secova Metals (SEK.v) Corporate Presentation

Presentation
PresentationPresentation
Presentation

Precious metals summit 2019, beaver creek
Precious metals summit 2019, beaver creekPrecious metals summit 2019, beaver creek
Precious metals summit 2019, beaver creek

Silver One Resources Corporate Presentation September 2021
Silver One Resources Corporate Presentation September 2021Silver One Resources Corporate Presentation September 2021
Silver One Resources Corporate Presentation September 2021

Peterdavies 140303205825-phpapp01
Peterdavies 140303205825-phpapp01Peterdavies 140303205825-phpapp01
Peterdavies 140303205825-phpapp01

2018 Falco Presentation
2018 Falco Presentation2018 Falco Presentation
2018 Falco Presentation

Falco jan2018
Falco jan2018Falco jan2018
Falco jan2018

Similar to 30.2 falco presentation rbc august 2017 100dpi

February 2016 Corporate Presentation
February 2016 Corporate PresentationFebruary 2016 Corporate Presentation
February 2016 Corporate PresentationFalcoCorporate

17.7 falco presentation bmo
17.7 falco presentation   bmo17.7 falco presentation   bmo
17.7 falco presentation bmoFalcoCorporate

March 2015 Corporate Presentation
March 2015 Corporate Presentation March 2015 Corporate Presentation
March 2015 Corporate Presentation FalcoCorporate

March 2015 investor presentation
March 2015 investor presentationMarch 2015 investor presentation
March 2015 investor presentationFalcoCorporate

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised coverFalcoCorporate

March 2015-investor-presentation
March 2015-investor-presentationMarch 2015-investor-presentation
March 2015-investor-presentationFalcoCorporate

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised coverFalcoCorporate

20.1 falco presentation may 2017
20.1 falco presentation   may 201720.1 falco presentation   may 2017
20.1 falco presentation may 2017FalcoCorporate

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised coverFalcoCorporate

March 2015 Corporate Presentation
March 2015 Corporate Presentation March 2015 Corporate Presentation
March 2015 Corporate Presentation FalcoCorporate

21.1 falco presentation august 2017 100dpi
21.1 falco presentation   august 2017 100dpi21.1 falco presentation   august 2017 100dpi
21.1 falco presentation august 2017 100dpiFalcoCorporate

12.3 2016 investor presentation
12.3 2016 investor presentation12.3 2016 investor presentation
12.3 2016 investor presentationFalcoCorporate

2015 investor-presentation-vancouver-april v001-s68iw2
2015 investor-presentation-vancouver-april v001-s68iw22015 investor-presentation-vancouver-april v001-s68iw2
2015 investor-presentation-vancouver-april v001-s68iw2FalcoCorporate

2015 investor presentation june
2015 investor presentation   june2015 investor presentation   june
2015 investor presentation juneFalcoCorporate

2015.01.12 probe mines presentation_website
2015.01.12 probe mines presentation_website2015.01.12 probe mines presentation_website
2015.01.12 probe mines presentation_websiteAdnet Communications

September 2015 Corporate Presentation
September 2015 Corporate PresentationSeptember 2015 Corporate Presentation
September 2015 Corporate PresentationFalcoCorporate

CRK AGM presentation May 18 2011
CRK AGM presentation May 18  2011CRK AGM presentation May 18  2011
CRK AGM presentation May 18 2011Crocodile Gold

2022.09.06 Quarterly Update Probe final.pdf
2022.09.06 Quarterly Update Probe final.pdf2022.09.06 Quarterly Update Probe final.pdf
2022.09.06 Quarterly Update Probe final.pdfseemasindwani

50.1 falco presentation feasibility - final(1)
50.1 falco presentation   feasibility - final(1)50.1 falco presentation   feasibility - final(1)
50.1 falco presentation feasibility - final(1)FalcoCorporate

Similar to 30.2 falco presentation rbc august 2017 100dpi (20)

February 2016 Corporate Presentation
February 2016 Corporate PresentationFebruary 2016 Corporate Presentation
February 2016 Corporate Presentation

17.7 falco presentation bmo
17.7 falco presentation   bmo17.7 falco presentation   bmo
17.7 falco presentation bmo

March 2015 Corporate Presentation
March 2015 Corporate Presentation March 2015 Corporate Presentation
March 2015 Corporate Presentation

March 2015 investor presentation
March 2015 investor presentationMarch 2015 investor presentation
March 2015 investor presentation

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised cover

March 2015-investor-presentation
March 2015-investor-presentationMarch 2015-investor-presentation
March 2015-investor-presentation

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised cover

20.1 falco presentation may 2017
20.1 falco presentation   may 201720.1 falco presentation   may 2017
20.1 falco presentation may 2017

March 2015 investor presentation revised cover
March 2015 investor presentation revised coverMarch 2015 investor presentation revised cover
March 2015 investor presentation revised cover

March 2015 Corporate Presentation
March 2015 Corporate Presentation March 2015 Corporate Presentation
March 2015 Corporate Presentation

21.1 falco presentation august 2017 100dpi
21.1 falco presentation   august 2017 100dpi21.1 falco presentation   august 2017 100dpi
21.1 falco presentation august 2017 100dpi

12.3 2016 investor presentation
12.3 2016 investor presentation12.3 2016 investor presentation
12.3 2016 investor presentation

2015 investor-presentation-vancouver-april v001-s68iw2
2015 investor-presentation-vancouver-april v001-s68iw22015 investor-presentation-vancouver-april v001-s68iw2
2015 investor-presentation-vancouver-april v001-s68iw2

2015 investor presentation june
2015 investor presentation   june2015 investor presentation   june
2015 investor presentation june

2015.01.12 probe mines presentation_website
2015.01.12 probe mines presentation_website2015.01.12 probe mines presentation_website
2015.01.12 probe mines presentation_website

September 2015 Corporate Presentation
September 2015 Corporate PresentationSeptember 2015 Corporate Presentation
September 2015 Corporate Presentation

CRK AGM presentation May 18 2011
CRK AGM presentation May 18  2011CRK AGM presentation May 18  2011
CRK AGM presentation May 18 2011

2022.09.06 Quarterly Update Probe final.pdf
2022.09.06 Quarterly Update Probe final.pdf2022.09.06 Quarterly Update Probe final.pdf
2022.09.06 Quarterly Update Probe final.pdf

Rubicon Minerals June 2017 Fact Sheet
Rubicon Minerals June 2017 Fact SheetRubicon Minerals June 2017 Fact Sheet
Rubicon Minerals June 2017 Fact Sheet

50.1 falco presentation feasibility - final(1)
50.1 falco presentation   feasibility - final(1)50.1 falco presentation   feasibility - final(1)
50.1 falco presentation feasibility - final(1)

More from FalcoCorporate

50.1 falco presentation feasibility - final - v2
50.1 falco presentation   feasibility - final - v250.1 falco presentation   feasibility - final - v2
50.1 falco presentation feasibility - final - v2FalcoCorporate

10.3 2016 investor presentation pea
10.3 2016 investor presentation   pea10.3 2016 investor presentation   pea
10.3 2016 investor presentation peaFalcoCorporate

9.2 2016 investor presentation
9.2 2016 investor presentation9.2 2016 investor presentation
9.2 2016 investor presentationFalcoCorporate

9.1 2016 investor presentation
9.1 2016 investor presentation9.1 2016 investor presentation
9.1 2016 investor presentationFalcoCorporate

Septembre 2015 Présentation
Septembre 2015 PrésentationSeptembre 2015 Présentation
Septembre 2015 PrésentationFalcoCorporate

2015 presentation-investisseurs-juin
2015 presentation-investisseurs-juin2015 presentation-investisseurs-juin
2015 presentation-investisseurs-juinFalcoCorporate

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation frFalcoCorporate

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation frFalcoCorporate

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation frFalcoCorporate

More from FalcoCorporate (9)

50.1 falco presentation feasibility - final - v2
50.1 falco presentation   feasibility - final - v250.1 falco presentation   feasibility - final - v2
50.1 falco presentation feasibility - final - v2

10.3 2016 investor presentation pea
10.3 2016 investor presentation   pea10.3 2016 investor presentation   pea
10.3 2016 investor presentation pea

9.2 2016 investor presentation
9.2 2016 investor presentation9.2 2016 investor presentation
9.2 2016 investor presentation

9.1 2016 investor presentation
9.1 2016 investor presentation9.1 2016 investor presentation
9.1 2016 investor presentation

Septembre 2015 Présentation
Septembre 2015 PrésentationSeptembre 2015 Présentation
Septembre 2015 Présentation

2015 presentation-investisseurs-juin
2015 presentation-investisseurs-juin2015 presentation-investisseurs-juin
2015 presentation-investisseurs-juin

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation fr

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation fr

March 2015 investor presentation fr
March 2015 investor presentation frMarch 2015 investor presentation fr
March 2015 investor presentation fr

Recently uploaded

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Sysco_Investors

Teck Investor Presentation - May 23, 2024
Teck Investor Presentation - May 23, 2024Teck Investor Presentation - May 23, 2024
Teck Investor Presentation - May 23, 2024TeckResourcesLtd

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Sysco_Investors

Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024CollectiveMining1

cyberagent_For New Investors_EN_240424.pdf
cyberagent_For New Investors_EN_240424.pdfcyberagent_For New Investors_EN_240424.pdf
cyberagent_For New Investors_EN_240424.pdfCyberAgent, Inc.

BRL - Investor Presentation - May 2024.pdf
BRL - Investor Presentation - May 2024.pdfBRL - Investor Presentation - May 2024.pdf
BRL - Investor Presentation - May 2024.pdfTyler Hosey

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Sysco_Investors

Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024CollectiveMining1

一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理
一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理
一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理btohy

一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理
一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理
一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理aytyn

Recently uploaded (10)

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024

Teck Investor Presentation - May 23, 2024
Teck Investor Presentation - May 23, 2024Teck Investor Presentation - May 23, 2024
Teck Investor Presentation - May 23, 2024

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024

Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024

cyberagent_For New Investors_EN_240424.pdf
cyberagent_For New Investors_EN_240424.pdfcyberagent_For New Investors_EN_240424.pdf
cyberagent_For New Investors_EN_240424.pdf

BRL - Investor Presentation - May 2024.pdf
BRL - Investor Presentation - May 2024.pdfBRL - Investor Presentation - May 2024.pdf
BRL - Investor Presentation - May 2024.pdf

Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024Investor Day 2024 Presentation Sysco 2024
Investor Day 2024 Presentation Sysco 2024

Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024Collective Mining | Corporate Presentation - May 2024
Collective Mining | Corporate Presentation - May 2024

一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理
一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理
一比一原版CBU毕业证卡普顿大学毕业证成绩单如何办理

一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理
一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理
一比一原版MQU毕业证麦考瑞大学毕业证成绩单如何办理

30.2 falco presentation rbc august 2017 100dpi

  • 1. THE NEXT GREAT UNDERGROUND MINE IN CANADA Corporate Presentation RBC Mining’s Rising Stars – August 2017 WWW.FALCORES.COM | FPC:TSXV
  • 2. Disclaimer This presentation contains a review of the Company’s properties in Canada. Viewers are cautioned that the projects are at an early stage of exploration and that estimates and projections contained herein are based on limited and incomplete data. More work is required before the mineralization on the projects and their economic aspects can be confidentaly modeled. Therefore, the work results and estimates herein may be considered to be generally indicative only of the nature and quality of the projects. No representation or prediction is intended as to the results of future work, nor can there be any promise that the estimates herein will be confirmed by future exploration or analysis, or that the projects will otherwise prove to be economic. The TSX Venture Exchange has not reviewed and does not accept responsibility for the accuracy or adequacy of this presentation, which has been prepared by management. There can be no assurance that any of the assumptions in the resource estimates will be supported by a Pre-feasibility or Feasibility Study or that any forward looking event will come to pass. The data is incomplete and considerable additional work will be required to complete further evaluation, including but not limited to drilling, engineering and socio-economic studies and investment. Past performance is no guarantee of future performance and all investors are urged to consult their investment professionals before making an investment decision. Investors are further cautioned that past performance is no guarantee of future performance Forward-Looking Statements Certain information included in this presentation constitutes forward-looking statements, including any information as to our projects, plans and future performance. All statements, other than statements of historical fact, are forward-looking statements. The words “expect”, “believe”, “anticipate”, “will”, “intend”, “estimate”, “forecast”, “budget”, “schedule” and similar expressions identify forward-looking statements. Forward-looking statements are necessarily based upon a number of factors and assumptions that, while considered reasonable by management, are inherently subject to significant business, economic and competitive uncertainties and contingencies. Known and unknown factors could cause actual results to differ materially from those projected in the forward-looking statements. Such factors include, but are not limited to: changes to current estimates of mineral resources; labour availability; litigation; availability of and increased costs associated with contractors and exploration equipment; the speculative nature of mineral exploration and development, including the risks of obtaining necessary licenses and permits; contests over title to properties; uncertainty with the Company’s ability to secure capital to execute its business plans; changes in national and local government legislation in Canada; risk of loss due to sabotage and civil disturbances; risks arising from holding derivative instruments; and business opportunities that may be pursued by the Company. Many of these uncertainties and contingencies can affect our actual results and could cause actual results to differ materially from those expressed or implied in any forward-looking statements made by, or on behalf of, us. Readers are cautioned that forward-looking statements are not guarantees of future performance. The Company disclaims any intention or obligation to update or revise any forward-looking statements whether as a result of new information, future events or otherwise, except as required by applicable law. Cautionary Note to U.S Investors Concerning Measured, Indicated and Inferred Resources This presentation uses the terms “measured,” “indicated” and “inferred resources. We advise investors that while those terms are recognized and required by Canadian regulations, the United States Securities and Exchange commission does not recognize them. Under Canadian rules, estimates of inferred mineral resources may not form the basis of feasibility or other economic studies. United States investors are cautioned not to assume that all or any part of measured or indicated mineral resources will ever be converted into mineral reserves. United States investors are also cautioned not to assume that all or any part of an inferred mineral resource exists, or is economically or legally mineable. CAUTIONARY STATEMENT
  • 3. TSXV: FPC | WWW.FALCORES.COM | 3 TSXV:FPC C$192M MARKET CAP ~C$46.2M CASH & CASH EQUIVALENTS 7.1 Moz AuEq M&I TOTAL RESOURCES 1.7 Moz AuEq Inferred TOTAL RESOURCES 236,000 GOLD OZ ESTIMATED AVERAGE GOLD ANNUAL PRODUCTION US$427 PER GOLD OZ ALL-IN SUSTAINING COST US$680M DEVELOPMENT CAPITAL EXPENDITURE >12 YEARS INITIAL MINE LIFE
  • 4. TSXV: FPC | WWW.FALCORES.COM | 4 EXPERIENCED SENIOR LEADERSHIP TEAM  Luc Lessard, President & CEO, Director  Vincent Metcalfe, CFO  Claude Léveillée, VP Community Relations & HR  Anthony Glavac, VP – Controller  Helene Cartier, VP – Environment  Francois Vezina, VP – Mining  Christian Laroche, VP – Processing  John-Paul McGrath – Project Manager  Claude Bernier, Exploration Manager  Sylvain Doire, Environment  Claude Pilote, Senior Geologist  Daniel Mathieu – Mechanical Designer EXECUTIVE MANAGEMENT BOARD OF DIRECTORS  Sean Roosen, Chair  Mario Caron, Lead Director  Bryan Coates  Paola Farnesi  Claude Ferron  Paul Henri-Girard  Chantal Sorel
  • 5. TSXV: FPC | WWW.FALCORES.COM | 5 CAPITAL SUMMARY & SHAREHOLDER REGISTRY SHAREHOLDER REGISTRY Osisko Gold Royalties 13.2% Tocqueville 9.2% Investissement Quebec 5.2% Oppenheimer Funds 2.0% Old Mutual 1.6% RBIM 1.1% CIBC Asset Management 1.0% Caisse de Depot du Quebec 1.0% Shares Outstanding (basic) 179,644,768 Stock Options 9,151,736 Warrants 28,281,717 Shares Outstanding (fully diluted) 205,934,721 Share Price C$1.07 Market Capitalization C$192.2 Cash Position ~C$42.6 Million CAPITAL STRUCTURE (AS OF AUG 15, 2017) Source: Factset, Bloomberg, public filings and Company estimates
  • 6. TSXV: FPC | WWW.FALCORES.COM | 6 HORNE 5 PROJECT| LOCATION  Located in Rouyn-Noranda, Québec, Canada  Access to better & experienced miners due to better work-life balance & conditions  Eliminates the need for a camp  Experienced labour pool  The region of Abitibi produces some of the most experienced miners in the world  Experienced suppliers  Access to tier 1 mining equipment suppliers & mining contractors in the world  ~80% of required suppliers & contractors located within 1 hour from project  Québec Government  Strong supporter of the mining industry  Clear permitting process & BAPE process for operations over 2,000 tpd  Great infrastructure  Rail & highway access  Affordable and reliable power source HORNE 5 MONTREAL
  • 7. TSXV: FPC | WWW.FALCORES.COM | 7 HORNE 5 PROJECT| MINERALIZATION  The Horne Mine orebodies (Upper H, Lower H and Horne 5 deposit)  Dip subvertically within rhyolitic flows, breccias, and tuffs that are bounded by the Andesite and the Horne Creek faults.  Least-altered rhyolites have low K2O contents and other geochemical features that place them within the FII tholeiitic series (Lesher et al., 1986)  Graded volcaniclastic beds, metal zoning in the orebodies, and locations of chloritized- mineralized rhyolites indicate that the volcanic sequence youngs to the north.  The volcanics in the fault wedge are variably silicified and sericitized, and local zones in the orebody sidewalls and footwall are chloritized  The Horne Block lies between the Horne Creek Fault and the Andesite Fault
  • 8. TSXV: FPC | WWW.FALCORES.COM | 8 HIGH GRADE ZONES HORNE 5 PROJECT| LONG & CROSS SECTIONS OF THE DEPOSIT MINERAL ENVELOPS MEASURED & INDICATED + INFERRED (at C$55 NSR cut-off) Resource Class Tonnes Au Equivalent g/t Au g/t Ag g/t Cu % Zn % Contained Au EQ (mm oz) Contained Au (mm oz) Contained Ag (oz) Contained Cu (mm lbs) Contained Zn (mm lbs) Measured 9.4 2.45 1.58 16.33 0.18 0.81 736 475 4,914 37.7 167.4 Indicated 81.7 2.41 1.56 14.19 0.18 0.86 6,336 4,088 37,295 315.8 1,552.7 Total M&I 91.1 2.41 1.56 14.41 0.18 0.86 7,072 4,564 42,209 353.5 1,720.1 Inferred 22.3 2.39 1.47 22.98 0.20 0.68 1,710 1,053 16,463 99.2 336.1
  • 9. TSXV: FPC | WWW.FALCORES.COM | 9 HORNE 5 PROJECT| THE NEW PROJECT – THE NEW VISION  A state-of-the-art UNDERGROUND MINING project  MAXIMIZE USE OF EXISTING INFRASTRUCTURE  Bulk tonnage operation  Highly efficient mining methods  15,000 tonnes per day mill  Limited footprint on surface with use of historical voids and stopes for waste and tailings disposal  236,000 ounces of avg. annual GOLD production  US$427 per ounce all-in cash cost  Development Capital Investments of US$680 million  525 full-time jobs during operation : >12 years  800 jobs during 18-24 construction period NEW MINE: HORNE 5 PROJECT 16 M AuEq Oz Produced 7.1 M AuEq Oz M&I 1.7 M AuEq Oz Inferred
  • 10. TSXV: FPC | WWW.FALCORES.COM | 10 HORNE 5 PROJECT| HIGH LEVEL OF AUTOMATION  STATE-OF-THE-ART OPERATION  Surface control underground operations:  Hoist – production and services  Teleoperation of loaders  Monitoring and management of ventilation requirements and paste backfill distribution  Water pumping monitoring  Staff & equipment location monitoring  HIGH CAPACITY PRODUCTION MINING EQUIPMENT  Scoop tram: 21 metric tonnes  Haulage truck: 63 metric tonnes  Conveyor system from deposit to Quemont shaft  Ability to operate between working shifts (20h/day vs 14h/day for a conventional mine)
  • 11. TSXV: FPC | WWW.FALCORES.COM | 11 HORNE 5 PROJECT| MINING APPROACH FOR FEASIBILITY >17 YEARS OF LIFE  EXISTING SHAFT
  • 12. TSXV: FPC | WWW.FALCORES.COM | 12 Project Potash Corp Ukraine KJRK Phase 1 Ukraine KJRK Phase 2 Horne 5 Phase 1 Horne 5 Phase 2 Depth (m) 1,200 1,340 1,800 1,200 1,800 Speed (m/s) 18-20 19 19 18 18 Operating Hours 19-20 22 22 19 19 Skip capacity (t) 40-65 50 50 43 39.4 Productivity (tpd) 25,000-30,000 22,050 17,640 23,200 16,550 HORNE 5 PROJECT| HOISTING COMPARABLES 43T SKIP – Similar to Horne 5 Sizing
  • 13. TSXV: FPC | WWW.FALCORES.COM | 13 Goldex (Agnico Eagle) Young-Davidson (Alamos) LaRonde (Agnico Eagle) Horne 5 PEA (Falco) Resource Grade (g/t AuEq) 1.8 2.8 5.1 2.9 Mining Method Long hole Transverse long hole Longitudinal Retreat / Transverse Open Stoping Transverse long hole Depth (m) 800 - 1,500 750 - 1,500 2,000-3,000 600 - 2,300 Stope Size 15-38 x 30 x 50 20-25 x 20 x 30 5-25 x 15 x 30 38 x 15 x 15 Mining Rate 5,100 tpd 8,000 tpd * 7,200 tpd 15,000 tpd Specific Gravity 2.8 2.69 3.3 3.45 Mining Dilution 15% 10%-20% 10%-20% < 4% Operating Cost/NSR $41/t * $53.50/t * $95/t $47.50/T* Annual Production (koz) 71,000 * 200,000 * 230,000 * 236,000* * Projected life-of-mine (LOM) Source: Company website, technical reports and filings from SEDAR HORNE 5 PROJECT| HIGH MARGIN PROJECT
  • 14. TSXV: FPC | WWW.FALCORES.COM | 14 HORNE 5 PROJECT| MINING METHOD & PROCESSING  Bulk Tonnage & Transverse Long Hole  Stope size 38m X 25m X 20m (~65,000 t per stope)  Primary – secondary stope mining sequencing  Production drilling in ore at 6.5 inches  Stope paste backfill to ensure stability PROCESS PLANT  Mill throughput of 15,000 tpd  SAG-Ball mill as primary comminution circuit (55 microns)  Three selective flotation circuits (copper, zinc, pyrite)  Fine regrind circuit of pyrite concentrate as secondary comminution circuit (15 microns)  Leaching/CIP of the two pyrite flotation circuit streams  Precious metal stripping circuit (elution and refining)  Cyanide destruction circuit (Carot Acid < 10ppm)
  • 15. TSXV: FPC | WWW.FALCORES.COM | 15 HORNE 5 PROJECT| PROPOSED FLOWSHEET 67%8% 15% 10% NSR REVENUE SPLIT (from PEA) Gold Silver Zinc Copper Note: Commodity Price Assumptions in US$ - $1,250/oz Au, $17.00/oz AG, $2.85/lb CU, $1.00/lb ZN PROCESS PLANT PRODUCTS  Copper concentrate (+/- 140 tpd)  Zinc concentrate (+/- 240 tpd)  Ag-Au ingot
  • 16. TSXV: FPC | WWW.FALCORES.COM | 16 HORNE 5 PROJECT| DEVELOPMENT CAPITAL EXPENDITURES US$680M $186 $265 $16 $74 $14 $82 $45 Mining Processing Plant Electrical and Communication Site Infrastructure Tailings and Water Management Indirects Contingency TOTAL PRE-PRODUCTION CAPITAL COSTS US$680M Note: Amounts may vary due to rounding. *FROM PEA
  • 17. TSXV: FPC | WWW.FALCORES.COM | 17 HORNE 5 PROJECT| FEASIBILITY ADVANCING – SURFACE
  • 18. TSXV: FPC | WWW.FALCORES.COM | 18 $13 $128 $89 $71 $3 $76 $68 $53 $51 $39 $36 $29 $25 $23 $11 $10 $8 TMAC Pretium GoldRoad Kaminak Dalradian Sabina Lundin Continental Victoria BeloSun MidasGold FirstMining Falco CharaatGold TaungGold Newcastle Exeter (1) (1) EV / RESOURCES (US$/OZ AU EQ.) $164 $1,506 $734 $404 $133 $496 $485 $458 $433 $365 $296 $239 $228 $204 $169 $139 $83 Pretium TMAC Lundin Continental GoldRoad Sabina Kaminak Dalradian FirstMining BeloSun Victoria MidasGold TaungGold Falco Newcastle Exeter CharaatGold (1) (1) MARKET CAP. (US$ MM) COMPARABLES – PRE-PRODUCTION > 5 M OZS & CAPEX BELOW $1BN IN PRODUCTION OR ACQUIRED 1. Acquisition Multiple Source: Company websites, filings from SEDAR and Factset
  • 19. TSXV: FPC | WWW.FALCORES.COM | 19 ALL-IN SUSTAINING CASH COST (US$/OZ AU) $427 $446 $524 $750 $752 $492 $583 $605 $616 $620 $623 $634 $674 $690 $779 $855 $860 Falco Pretium Continental Kaminak TaungGold CharaatGold MidasGold Sabina Lundin Victoria Dalradian GoldRoad TMAC Exeter BeloSun Newcastle FirstMining 17 20 18 18 11 20 18 17 17 14 13 13 12 12 11 11 10 TMAC TaungGold Exeter Pretium CharaatGold Falco BeloSun Newcastle Continental GoldRoad Lundin MidasGold Sabina Kaminak FirstMining Dalradian Victoria LIFE OF MINE (YEARS) COMPARABLES – PRE-PRODUCTION > 5 M OZS & CAPEX BELOW $1BN 1. Payback period not disclosed. Source: Company websites, filings from SEDAR and Factset IN PRODUCTION OR ACQUIRED M&I ONLY
  • 20. TSXV: FPC | WWW.FALCORES.COM | 20 PROJECT SCHEDULE – On the Road to Feasibility & Development ACTIVITIES START COMPLETION PEA COMPLETED Feasibility Study Q2 2016 Q3 2017 Environmental Impact assessment Q2 2016 Q4 2017 Dewatering (Phase 1) Q4 2017 Q2 2019 Detailed engineering Q3 2017 Q4 2018 Head frame and hoist construction (Exploration Phase) Q4 2017 Q3 2018 Public audiences – “BAPE” Q4 2017 Q1 2019 Permits for project construction Q2 2019 Processing plant construction Q2 2019 First mineralized ore in mine Q1 2021 Full Mine ramp up (Phase 1) H1 2021 End of process plant construction / plant commissioning H1 2021 Process plant ramp up H2 2021
  • 21. TSXV: FPC | WWW.FALCORES.COM | 21 FALCO RESOURCES – 2017 EXPLORATION PROGRAM – REGIONAL RIMO Lac Laynes Routhier NORALEX Dufresnor Baie D’Alembert Four Corners - Beauchastel Gold Viau - Lac Hervé Horne 5 Project Flavrian
  • 22. TSXV: FPC | WWW.FALCORES.COM | 22 Head Office Falco Resources Ltd. 1100, avenue des Canadiens-de-Montréal Bureau 300 Montréal, QC H3B 2S2 Tél. : +1.514.905.3162 Toll Free : +1.888.915.2009 Courriel : info@falcores.com Investor Inquiries Vincent Metcalfe, CFO Tel: +1.514.905.3162 Email: vmetcalfe@falcores.com CONTACT US
  • 23. TSXV: FPC | WWW.FALCORES.COM | 23 APPENDIX Appendix A – PEA Additional Information Appendix B – Resource & Modeling Notes Appendix C – Research Coverage
  • 24. TSXV: FPC | WWW.FALCORES.COM | 24 Appendix A - HORNE 5 PROJECT LOCATED NORTH OF THE CITY OF ROUYN-NORANDA HORNE 5 PROJECT LOCATED IN AN INDUSTRIAL PARK City of Rouyn-Noranda Smelter Horne Mine Quemont Shaft Falco Surface Rights Industrial Park Rail Highway
  • 25. TSXV: FPC | WWW.FALCORES.COM | 25 Appendix A – @ C$55NSR Note: Commodity Price Assumptions in US$ - $1,300/oz Au, $18.50/oz AG, $2.15/lb CU, $1.00/lb ZN Resource Class Cut-off (NSR C$) Tonnes Au Equivalent g/t Au g/t Ag g/t Cu % Zn % Contained Au EQ (oz) Contained Au (oz) Contained Ag (oz) Contained Cu (lbs) Contained Zn (lbs) > 40 112,837,300 2.19 1.40 13.51 0.16 0.77 7,933,432 5,092,093 49,006,097 404,004,013 1,918,532,372 > 45 105,660,800 2.26 1.45 13.80 0.17 0.80 7,675,704 4,934,128 46,895,548 388,219,896 1,861,812,513 > 50 98,431,300 2.34 1.50 14.10 0.17 0.83 7,389,520 4,758,936 44,630,965 371,415,421 1,795,554,378 > 55 91,096,800 2.41 1.56 14.41 0.18 0.86 7,072,273 4,563,793 42,209,208 353,502,913 1,720,132,089 > 60 83,674,500 2.50 1.62 14.74 0.18 0.89 6,724,071 4,348,340 39,658,845 334,697,744 1,635,170,900 > 65 76,164,000 2.59 1.68 15.10 0.19 0.92 6,343,817 4,114,360 36,964,321 314,464,092 1,538,362,827 > 70 68,857,000 2.69 1.75 15.44 0.19 0.94 5,946,460 3,872,056 34,187,862 293,539,891 1,433,144,432 > 75 61,768,900 2.79 1.82 15.78 0.20 0.97 5,534,345 3,622,782 31,338,658 272,412,325 1,319,587,642 > 80 55,205,800 2.89 1.90 16.07 0.21 0.99 5,128,157 3,379,201 28,514,569 252,090,038 1,204,136,268 > 85 48,979,500 3.00 1.99 16.32 0.22 1.01 4,719,916 3,133,727 25,694,362 232,283,780 1,087,297,243 > 90 43,127,300 3.11 2.08 16.53 0.22 1.02 4,314,767 2,889,443 22,920,820 212,895,273 971,164,640 > 95 37,708,700 3.23 2.19 16.76 0.23 1.03 3,920,117 2,649,110 20,318,763 194,147,093 859,000,393 > 100 32,847,800 3.36 2.29 16.93 0.24 1.04 3,547,992 2,423,233 17,878,830 176,525,171 751,901,217 Resource Class Cut-off (NSR C$) Tonnes Au Equivalent g/t Au g/t Ag g/t Cu % Zn % Contained Au EQ (oz) Contained Au (oz) Contained Ag (oz) Contained Cu (lbs) Contained Zn (lbs) > 40 29,982,700 2.09 1.27 20.20 0.18 0.62 2,018,308 1,225,760 19,474,995 121,579,421 408,634,980 > 45 27,554,500 2.18 1.33 21.03 0.19 0.64 1,930,445 1,176,117 18,634,351 114,786,950 389,104,374 > 50 24,940,000 2.28 1.39 21.98 0.20 0.66 1,826,125 1,116,815 17,622,512 107,406,534 365,167,423 > 55 22,283,200 2.39 1.47 22.98 0.20 0.68 1,709,902 1,053,061 16,463,471 99,171,805 336,101,668 > 60 20,058,400 2.49 1.54 23.94 0.21 0.70 1,604,361 995,491 15,437,436 91,439,498 309,347,419 > 65 17,472,900 2.62 1.64 25.21 0.21 0.72 1,472,114 922,946 14,159,498 80,661,116 278,551,219 > 70 15,293,600 2.75 1.74 26.48 0.21 0.74 1,352,929 856,634 13,019,250 71,823,610 249,906,179 > 75 13,406,500 2.88 1.84 27.70 0.22 0.75 1,242,755 794,507 11,940,661 64,601,999 222,924,808 > 80 11,528,900 3.04 1.96 29.10 0.23 0.77 1,126,483 727,514 10,784,724 57,409,881 195,709,438 > 85 9,821,100 3.21 2.11 30.25 0.23 0.78 1,014,192 664,774 9,552,769 50,654,094 168,612,199 > 90 8,222,900 3.41 2.29 30.98 0.25 0.77 902,741 604,603 8,189,164 44,700,861 139,977,418 > 95 6,927,000 3.63 2.48 31.57 0.26 0.76 807,727 552,850 7,030,524 39,678,474 115,974,677 > 100 5,912,700 3.84 2.68 32.15 0.27 0.74 729,660 509,966 6,112,206 35,554,367 96,081,089 Inferred Measured + Indicated
  • 26. TSXV: FPC | WWW.FALCORES.COM | 26 Appendix A - RESOURCE COMPARISON – APRIL 2014 MINERAL RESOURCE TO CURRENT Resource Category Measured Indicated Inferred Mineral Resource Estimate Cut-off (NSR C$) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) 2016 update (Sept. 26) > 55 9,361,800 1.58 16.33 0.18 0.81 81,735,100 1.56 14.19 0.18 0.86 22,283,200 1.47 22.98 0.20 0.68 2016 (Jan. 8) > 65 -- -- -- -- -- 58,346,300 1.82 15.60 0.20 1.00 12,678,700 2.10 26.26 0.22 0.57 Maiden 2014 (Feb. 17) > 80 -- -- -- -- -- -- -- -- -- -- 25,319,200 2.64 -- 0.23 0.70 Update ∆ Measured ∆ Indicated ∆ Inferred Mineral Resource Estimate Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) Tonnes Au (g/t) Ag (g/t) Cu (%) Zn (%) 2016 update vs. Jan. 2016 100% 100% 100% 100% 100% 40% -14% -9% -10% -14% 76% -30% -12% -9% 19% 2016 update vs. Maiden 2014 -- -- -- -- -- 100% 100% 100% 100% 100% -12% -44% 100% -13% -3% Resources have increased 310% from 2014 and 47% from earlier in 2016
  • 27. TSXV: FPC | WWW.FALCORES.COM | 27 Appendix A – Historical Drill Density of Horne 5 Deposit 600m HORNEQUEMONT  Exceptional Drill Density  4,384 underground drill holes at 15 m spacing (305,788m) drilled by Noranda  Very high confidence in historical drilling  Great upside at Depth – limited drilling vs. upper area
  • 28. TSXV: FPC | WWW.FALCORES.COM | 28 Appendix A – Horne 5 Deposit & 2015 Confirmation Drilling Program HORNEQUEMONT
  • 29. TSXV: FPC | WWW.FALCORES.COM | 29 Appendix A – Current Mineral Envelops
  • 30. TSXV: FPC | WWW.FALCORES.COM | 30 • NPV of $1.131 billion at a 5% discount rate and an IRR of 20.0% before taxes and mining duties • NPV of $667 million at a 5% discount rate and an IRR of 16.0% after taxes and mining duties • Peak-year production of 274 kozs and average LOM annual production of 236 kozs of gold • Net payable gold recovery of 86.8% • 3,051,000 gold ounces production at an average diluted grade of 2.60 g/t Au LOM • 2,903,000 ounces of payable gold LOM • 807 million pounds of payable zinc LOM • 194 million pounds of payable copper LOM • 23.8 million ounces of payable silver LOM • All-in sustaining costs* of US$427 PER PAYABLE GOLD OUNCE • All-in cost (CAPEX plus OPEX) is estimated at US$660 per payable gold ounce • Initial CAPEX of C$905 million (including a $60 million contingency) or US$680 million • Payback Period of 3.8 years pre-tax and 4.1 years post-tax • Gross Revenue of $6.8 billion and Operating Cash-flow of $2.6 billion • Start of production in 2020 • Full production in 2021 • Initial mine life of 12 years *All-in Sustaining Costs are presented as defined by the World Gold Council ("WGC") less Corporate G&A Note: Commodity Price Assumptions in US$ - $1,250/oz Au, $17.00/oz AG, $2.85/lb CU, $1.00/lb ZN Appendix A – Horne 5 Project Key Highlights
  • 31. TSXV: FPC | WWW.FALCORES.COM | 31 Appendix A – Proposed Flowsheet of Horne 5 Project
  • 32. TSXV: FPC | WWW.FALCORES.COM | 32 PROCESSING | SAG & Ball Mill with Cyclone Cluster
  • 33. TSXV: FPC | WWW.FALCORES.COM | 33 PROCESSING | Overall Flotation Tank
  • 34. TSXV: FPC | WWW.FALCORES.COM | 34 PROCESSING | Regrind Mill
  • 35. TSXV: FPC | WWW.FALCORES.COM | 35 PROCESSING | Carbon in Pulp
  • 36. TSXV: FPC | WWW.FALCORES.COM | 36 Source: Wood Mackenzie Ltd. And BMO Capital Markets * All-in Sustaining Costs are presented as defined by the World Gold Council ("WGC") less Corporate G&A $0 $500 $1,000 $1,500 $2,000 $2,500 2016 Gold Mine, Composite, Total Cash + Sustaining Capex Cost Grouped By Mine and Ranked By Total Cash plus Sustaining Capex TotalCash+SustainingCapex(US$/oz) 0 500 1000 1500 2000 Paid Gold (t) Horne 5 Project AISC of US$427/oz Appendix B – Low All-In Sustaining Cost, a Top Quartile Asset
  • 37. TSXV: FPC | WWW.FALCORES.COM | 37 NORALEX –Young Buck Longitudinal - looking NE Open
  • 38. TSXV: FPC | WWW.FALCORES.COM | 38 FLAVRIAN – Duprat Syenite Similar Magnetic signature to Upper Beaver ?  Similar context as Queenston’s Upper Beaver syenite;  1.2 km in diameter, 1 existing drill hole;  Two anomalous gold values on the contacts of the syenite;  Largely unexplored
  • 39. TSXV: FPC | WWW.FALCORES.COM | 39 CENTRAL CAMP – West Ansil – 1.7 KM of Ansil Inmont New Insco Bouchard-Hebert Horne Ansil Gallen Aldermac Corbet Millenbach 0 5 km Montbray Norbec Delbridge Amulet A-CWaite DEPOSIT Mt %Cu %Zn Opt Au Horne (H-G-E) 54.0 2.20 0.18 Quemont 15.0 1.22 1.90 0.12 Bouchard-Hebert lens 1100 10.2 0.72 5.39 0.04 Amulet Lower A 5.2 5.10 5.20 0.04 Norbec 4.3 2.77 4.70 0.02 Millenbach 3.5 3.50 4.50 0.03 Gallen 3.3 0.07 4.77 0.02 Corbet 2.7 2.90 2.00 0.03 East Waite 1.7 4.10 3.25 0.05 Ansil 1.4 7.18 0.80 0.06 Old Waite 1.2 4.70 2.98 0.03 New Insco (Not mined) 1.2 2.11 0.03 Delbridge 0.4 0.55 8.60 0.07
  • 40. TSXV: FPC | WWW.FALCORES.COM | 40 CENTRAL CAMP – West Ansil Massive Sulphide Zones Category (NI 43-101) Tons (MT) Cu % Zn % Au g/t Ag g/t Indicated Resource: 0.53 3.4 0.4 1.4 9.2 Inferred Resource: 0.60 3.3 0.2 0.3 5.9 AN-05-04 – 3.57% Cu over 52.7 m
  • 41. TSXV: FPC | WWW.FALCORES.COM | 41 Appendix B – Mineral Resource Estimates & Modeling Notes 1. The effective date of the resource estimate is September 26, 2016. The Independent and Qualified Persons for the Mineral Resource Estimate as required by National Instrument 43-101 are Carl Pelletier, P. Geo., B.Sc. and Guilhem Servelle, P.Geo., M.Sc., both employees of InnovExplo Inc. 2. Mineral Resources are not Mineral Reserves and have not demonstrated economic viability. 3. While the results are presented undiluted and in situ, the reported mineral resources are considered by the Qualified Persons to have reasonable prospects for economic extraction. 4. These estimates include six (6) low grade gold-bearing mineralized zones. 5. The principal low-grade gold-bearing mineralized zone includes six (6) high-grade gold-bearing zones, one (1) high-grade copper-bearing zone, one (1) high grade zinc-bearing zone, three (3) high-grade silver-bearing zones. Note that these high-grade zones may overlap each other. 6. Resources were compiled at NSR cut-offs of C$40, C$45, C$50, C$55, C$60, C$65, C$70, C$75, C$80, C$85, C$90, C$95, and C$100 per tonne for sensitivity purposes. 7. The official base case resource is reported at a C$55 per tonne NSR cut-off. 8. The appropriate NSR cut-off will vary depending on prevailing economic and operational parameters to be determined. 9. NSR estimates are based on the following assumptions: exchange rate of $C1.30/$US, metal prices of (all $US): gold $1,300/oz, silver $18.50, copper $2.15/lb, zinc $1.00/lb (Long term analyst consensus price forecast study). Net recoveries of 86.8% for gold, 74.9% for silver, 67.3% for zinc and 74.0% for copper. Smelting cost (including transportation) C$6.52 per tonne (based on the Cost Mine service as well as on non-public smelter contract obtained from one of the proposed destinations and on talks with transport providers). 10. Gold equivalent calculations assume these same metal prices. 11. Inferred resources are separate from Indicated Resources 12. The quantity and grade of reported Inferred Resources in this estimate are uncertain in nature and there has not been sufficient work to define these Inferred Resources as Indicated or Measured Resources. It is uncertain if further work will result in upgrading them to an Indicated or Measured mineral resource category. 13. The resource was estimated using Geovia GEMS 6.7. The estimate is based on 5,977 diamond drill holes (478,281m) of which 4,138 crosscut mineralized zones for a total of 177,996m of core within these zones. For silver the estimate also uses the results of an exhaustive metallurgical test comprising 2,112 diamond drill holes assayed for silver over a total length of 75,540 meters. A minimum true thickness of 7.0 m was applied, using the grade of the adjacent material when assayed, or a value of zero when not assayed. Only the silver interpolation in the Inferred resources does not use the material when not assayed. 14. The estimate database contains also 14,799 channel samples for a total of 23,791m from drifts historically sampled. Channel sample data was only used for distance to composite criterion for resource classification purposes. 15. 91% of density values were estimated using historical drill hole iron assays data and Falco density data for an average of 3.41 g/cm3. Interpolation method use 3 pass ID2 for the ENV_A and HG_A to HG_F zones. 8% of density values were fixed at 2.88 g/cm3 for ENV_B to ENV_E zones due to the scarcity of the data. 2.88 g/cm3 representing the median of the available data. 1% of density values were fixed at 2.67 g/cm3 for ENV_F zone due to the scarcity of the date and to adequately characterise this quartz-rich zone. 16. Compositing was done on drill hole sections falling within the mineralized zones (composite = 3.0 metres). Tails shorter than 0.75 m were not created. 17. Resources were evaluated from drill holes using an ID2 interpolation method in a block model (block size = 5 x 5 x 5 m). 18. High grade capping was done on raw assay data and established on a per zone basis for gold (Au g/t): (HG_A: 35; HG_B: 35; HG_C: 25; HG_D: 35; HG_E: 25; HG_F: 35; ENV_A: 35; ENV_B: 25; ENV_C: 25; ENV_D: 20; ENV_E: 35; ENV_F: 25) and for silver (Ag g/t): SG_HG:100; HG_D: 165; HG_F: 165; ENV_A_SG_Low: 110; ENV_B: 100; ENV_C: 100; ENV_D: 100. Capping grade selection is supported by statistical analysis. No capping was applied to the Cu and Zn data based on statistical analysis. 19. The Mineral Resources presented herein are categorized as Measured, Indicated and Inferred. The Inferred category is only defined within the areas where blocks were interpolated during pass 1 or pass 2 in areas where continuity is sufficient to avoid isolated blocks. The Indicated category is only defined by blocks interpolated in areas where the maximum distance to the closest drill hole composite is less than 25m for blocks interpolated in passes 1 and 2. The Measured category is only defined by blocks classified as indicated and in sufficient proximity to sampled drifts (< 15m). The average distance to the nearest composite is 6.97 meters for the Measured resources, 10.01 meters for the Indicated resources and 40.10 meters for the Inferred resources. 20. Tonnage estimates were rounded to the nearest hundred tonnes. Any discrepancies in the totals are due to rounding effects. Rounding practice follows the recommendations set out in Form 43- 101F1. 21. CIM definitions and guidelines were followed in estimating mineral resources. 22. InnovExplo is not aware of any known environmental, permitting, legal, title-related, taxation, socio-political, marketing or other relevant issue that could materially affect the mineral resource estimate. 23. Metal contained in ounces (troy) = metric tonnes x grade / 31.10348. Calculations used metric units (metres, tonnes and g/t). Metal contents are presented in ounces and pounds . RESOURCE ESTIMATE NOTES
