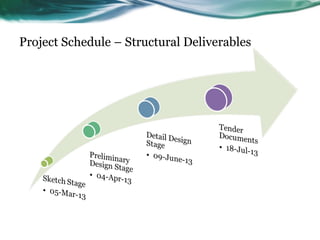

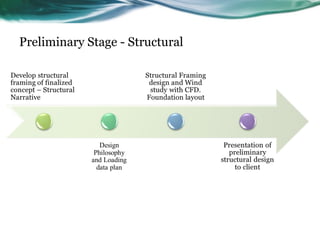

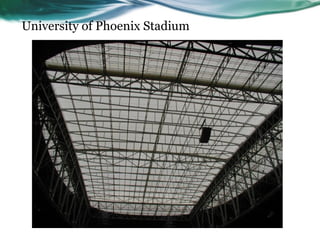

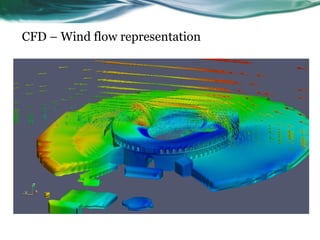

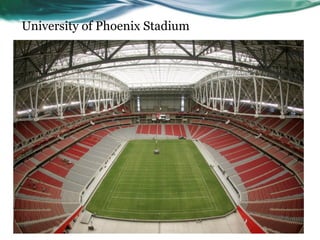

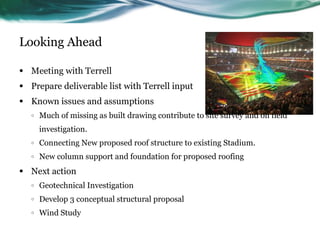

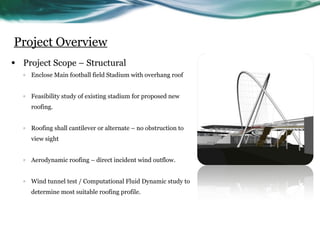

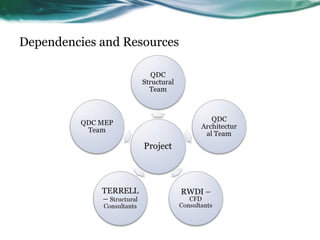

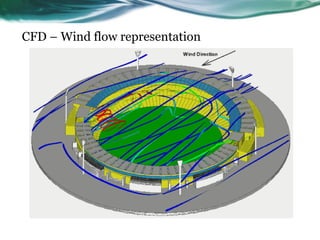

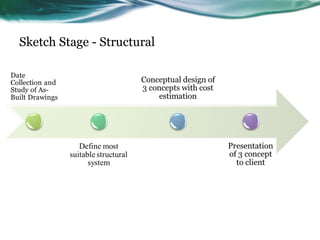

The document outlines the structural upgrade plans for Al-Arabi Stadium, including enclosing the main football field with an overhanging roof. It discusses performing a feasibility study of the existing stadium and roofing options, with the roof cantilevering out and allowing an unobstructed view. Wind tunnel testing and CFD studies will determine the most suitable roof profile. The schedule and deliverables are presented, along with known issues like connecting the new roof structure to the existing stadium. A case study of University of Phoenix Stadium is also included for its air-conditioned, collapsible central roof design.
