novagold.com
NYSE-MKT, TSX: NG | May 2015
The Institutional-Quality Gold Development Company
Cautionary Statements
REGARDING FORWARD-LOOKING STATEMENTS
This presentation includes certain “forward-looking statements” within the meaning of applicable securities laws, including the United States Private Securities Litigation Reform Act of 1995. All
statements, other than statements of historical fact, included herein including, without limitation, statements relating to Donlin Gold’s future operating or financial performance, are forward-
looking statements. Forward-looking statements are frequently, but not always, identified by words such as “plans”, “expects”, “anticipates”, “believes”, “intends”, “estimates”, “potential”,
“possible” and similar expressions, or statements that events, conditions or results “will”, “may”, “could”, or “should” occur or be achieved. These forward-looking statements are set forth in the
slides pertaining to the implementation of the Donlin Gold second updated Feasibility Study and pertaining to the implementation of the Galore Creek Pre-Feasibility Study, the factors that may
influence future gold price performance, and the potential future value of gold, and may include statements regarding perceived merit of properties; exploration results and budgets; mineral
reserves and resource estimates; work programs; capital expenditures; timelines; strategic plans; completion of transactions; market price of precious or base metals; or other statements that
are not statements of fact. Forward-looking statements involve various risks and uncertainties. There can be no assurance that such statements will prove to be accurate, and actual results and
future events could differ materially from those anticipated in such statements. Important factors that could cause actual results to differ materially from our expectations include the
uncertainties involving the need for additional financing to explore and develop properties and availability of financing in the debt and capital markets; uncertainties involved in the interpretation
of drilling results and geological tests and the estimation of reserves and resources; the need for continued cooperation between NOVAGOLD and Barrick Gold in the exploration and
development of the Donlin Gold property; the need for continued cooperation between NOVAGOLD and Teck Resources Ltd. in the exploration and development of the Galore Creek property;
the need for cooperation of government agencies and native groups in the development and operation of properties; the need to obtain permits and governmental approvals; risks of
construction and mining projects such as accidents, equipment breakdowns, bad weather, non-compliance with environmental and permit requirements, unanticipated variation in geological
structures, ore grades or recovery rates; unexpected cost increases; fluctuations in metal prices and currency exchange rates; and other risks and uncertainties disclosed in reports and
documents filed by NOVAGOLD with applicable securities regulatory authorities from time to time. The forward-looking statements made herein reflect our beliefs, opinions and projections on
the date the statements are made. Except as required by law, we assume no obligation to update the forward-looking statements of beliefs, opinions, projections, or other factors, should they
change.
REGARDING SCIENTIFIC AND TECHNICAL INFORMATION
Unless otherwise indicated, all reserve and resource estimates included in this presentation have been prepared in accordance with Canadian National Instrument 43-101 Standards of
Disclosure for Mineral Projects (“NI 43-101”) and the Canadian Institute of Mining, Metallurgy and Petroleum Definition Standards for Mineral Resources and Mineral Reserves (“CIM Definition
Standards”). Canadian standards, including NI 43-101, differ significantly from the requirements of the United States Securities and Exchange Commission (“SEC”), and reserve and resource
information in this presentation may not be comparable to similar information disclosed by U.S. companies. In particular, and without limiting the generality of the foregoing, the term “resource”
does not equate to the term “‘reserves”. Under U.S. standards, mineralization may not be classified as a “reserve” unless the determination has been made that the mineralization could be
economically and legally produced or extracted at the time the reserve determination is made. At this time, both of Donlin Gold and Galore Creek projects are without known reserves, as
defined under SEC Industry Guide 7. The SEC’s disclosure standards normally do not permit the inclusion of information concerning “measured mineral resources”, “indicated mineral
resources” or “inferred mineral resources” or other descriptions of the amount of mineralization in mineral deposits that do not constitute “reserves” by U.S. standards in documents filed with the
SEC. U.S. investors should also understand that “inferred mineral resources” have a great amount of uncertainty as to their existence and great uncertainty as to their economic and legal
feasibility. It cannot be assumed that all or any part of an “inferred mineral resource” will ever be upgraded to a higher category. Under Canadian rules, estimated “inferred mineral resources”
may not form the basis of feasibility or pre-feasibility studies except in rare cases. Investors are cautioned not to assume that all or any part of an “inferred mineral resource” exists or is
economically or legally mineable. Disclosure of “contained ounces” in a resource is permitted disclosure under Canadian regulations; however, the SEC normally only permits issuers to report
mineralization that does not constitute “reserves” by SEC standards as in-place tonnage and grade without reference to unit measures. The requirements of NI 43-101 for identification of
“reserves” are also not the same as those of the SEC, and reserves reported in compliance with NI 43-101 may not qualify as “reserves” under SEC standards. Accordingly, information
concerning mineral deposits set forth herein may not be comparable to information made public by companies that report in accordance with United States standards.
All dollar amounts quoted in this report are in U.S. currency unless otherwise noted.
2

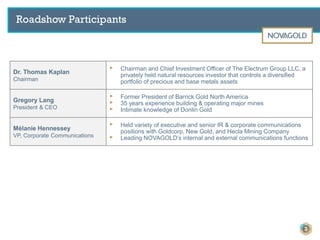

Roadshow Participants
Dr. Thomas Kaplan
Chairman
▸ Chairman and Chief Investment Officer of The Electrum Group LLC, a
privately held natural resources investor that controls a diversified
portfolio of precious and base metals assets
Gregory Lang
President & CEO
▸ Former President of Barrick Gold North America
▸ 35 years experience building & operating major mines
▸ Intimate knowledge of Donlin Gold
Mélanie Hennessey
VP, Corporate Communications
▸ Held variety of executive and senior IR & corporate communications
positions with Goldcorp, New Gold, and Hecla Mining Company
▸ Leading NOVAGOLD’s internal and external communications functions
3

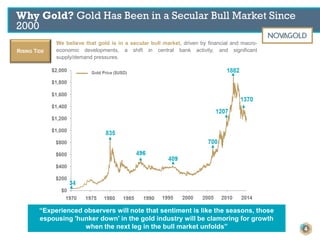

Why Gold? Gold Has Been in a Secular Bull Market Since
2000
RISING TIDE
We believe that gold is in a secular bull market, driven by financial and macro-
economic developments, a shift in central bank activity, and significant
supply/demand pressures.
“Experienced observers will note that sentiment is like the seasons, those
espousing 'hunker down' in the gold industry will be clamoring for growth
when the next leg in the bull market unfolds” 4

Why Gold? A Valuable Portfolio Diversifier
5
Comparative Returns
Note: T-note, and T-bond are average rates of return.
Gold provides excellent portfolio diversification due to its low correlation with most other asset classes,
including equities, bonds, other commodities, and the U.S. dollar.
Unlike other commodities, gold tends to retain value during recessions and deflationary periods.
Gold’s performance over the last decade vindicates its status as a valuable diversifier. Over the last decade,
gold has surged relative to other investment classes; it has outperformed equities, risen in price as oil fell,
and outperformed the Commodity Research Bureau (CRB) Futures Index by 25% between December 2009
and December 2014.
We believe it will continue to do so because gold is more than a mere commodity.
PORTFOLIO
DIVERSIFICATION
AND CAPITAL
PRESERVATION
Gold Has Retained Value in Uncertain Times
100.0%
40.0%
44.0%
89.0%
27.0%
(5.0%)
(50.0%)
(65.0%)
(31.0%)
(80.0%)
(60.0%)
(40.0%)
(20.0%)
0.0%
20.0%
40.0%
60.0%
80.0%
100.0%
120.0%
1814 to 1830 1864 to 1897 1929 to 1933
Gold Silver Other Commodities
SOURCE: INCREMENTUM AG.
“AFTER A 40-YEAR SECULAR TREND OF ATTEMPTED DE-MONETIZATION,
GOLD IS RE-ASSERTING ITSELF AS THE ONLY FINANCIAL ASSET THAT DOESN’T
REPRESENT SOMEONE ELSE’S LIABILITY”
SOURCE: CPM GROUP.
Percent Change
31-Dec-14 1 year 5 year 10 year
Gold $1,184.10 -1.5% 8.0% 170.1%
Silver $15.60 -19.5% -7.4% 128.2%
Oil $53.27 -45.9% -33.3% 22.6%
S&P 500 2,058.90 11.4% 84.6% 69.9%
FTSE 6566.09 -2.7% 21.3% 36.4%
Nikkei 17450.77 7.1% 65.5% 51.9%
MSCI World Index 1709.67 5.0% 48.8% 46.2%
$/Euro $1.21 -12.0% -15.5% -10.7%
10 Year T-Note 10.4% 29.2% 41.4%
30 Year T-Bond 27.3% 67.6% 95.8%
GOLD HAS BEEN THE BEST PERFORMING CURRENCY OVER THE LAST DECADE

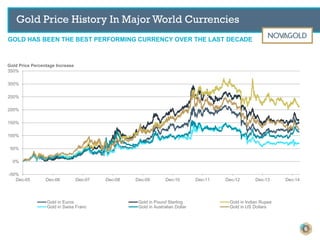

Gold Price History In Major World Currencies
6
-50%
0%
50%
100%
150%
200%
250%
300%
350%
Dec-05 Dec-06 Dec-07 Dec-08 Dec-09 Dec-10 Dec-11 Dec-12 Dec-13 Dec-14
Gold in Euros Gold in Pound Sterling Gold in Indian Rupee
Gold in Swiss Franc Gold in Australian Dollar Gold in US Dollars
Gold Price Percentage Increase

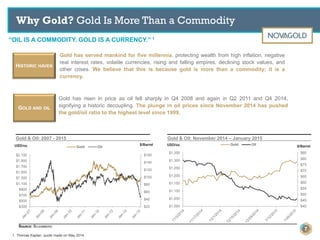

Why Gold? Gold Is More Than a Commodity
“OIL IS A COMMODITY. GOLD IS A CURRENCY.” 1
Gold has served mankind for five millennia, protecting wealth from high inflation, negative
real interest rates, volatile currencies, rising and falling empires, declining stock values, and
other crises. We believe that this is because gold is more than a commodity; it is a
currency.
HISTORIC HAVEN
Gold has risen in price as oil fell sharply in Q4 2008 and again in Q2 2011 and Q4 2014,
signifying a historic decoupling. The plunge in oil prices since November 2014 has pushed
the gold/oil ratio to the highest level since 1999.
GOLD AND OIL
1. Thomas Kaplan, quote made on May 2014.
Gold & Oil: 2007 - 2015 Gold & Oil: November 2014 – January 2015
USD/oz. USD/oz.$/Barrel $/Barrel
SOURCE: BLOOMBERG
$20
$40
$60
$80
$100
$120
$140
$160
$300
$500
$700
$900
$1,100
$1,300
$1,500
$1,700
$1,900
$2,100
Gold Oil
$40
$45
$50
$55
$60
$65
$70
$75
$80
$85
$1,000
$1,050
$1,100
$1,150
$1,200
$1,250
$1,300
$1,350
Gold Oil
7
Why Gold? Safe Haven that has Retained Its Value
8
HISTORICAL
DEFLATIONARY
PRECEDENT
Gold has historically retained value on a relative and absolute basis. When imploding asset classes created a
deflationary spiral in 2008 and 2009, oil, equities, currencies, agricultural and commodities declined. As a
safe haven, gold retained its value, as investors sought to protect their savings and hedge against financial
market default. In prior periods of significant economic downturn such as the Great Depression, average gold
prices rose.
Gold Prices vs. Change in CPI, September 2008 to March 2009
Monthly Data
SOURCE: CPM GROUP.
Past performance is not indicative of future results.
(2.0%)
(1.5%)
(1.0%)
(0.5%)
0.0%
0.5%
1.0%
$0
$200
$400
$600
$800
$1,000
Sep-08 Oct-08 Nov-08 Dec-08 Jan-09 Feb-09 Mar-09
MoM CPI Gold Price
“GOLD CAN FLOURISH IN INFLATION AND IT CAN FLOURISH IN DEFLATION.”
Change in CPIGold price $/oz.
Why Gold? It’s Scarce

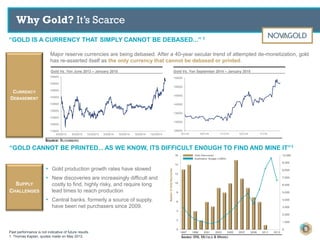

9
• Gold production growth rates have slowed
• New discoveries are increasingly difficult and
costly to find, highly risky, and require long
lead times to reach production
• Central banks, formerly a source of supply,
have been net purchasers since 2009.
SUPPLY
CHALLENGES
CURRENCY
DEBASEMENT
Major reserve currencies are being debased. After a 40-year secular trend of attempted de-monetization, gold
has re-asserted itself as the only currency that cannot be debased or printed.
Past performance is not indicative of future results
1. Thomas Kaplan, quotes made on May 2012.
“GOLD IS A CURRENCY THAT SIMPLY CANNOT BE DEBASED...” 1
“GOLD CANNOT BE PRINTED... AS WE KNOW, ITS DIFFICULT ENOUGH TO FIND AND MINE IT”1
Gold Vs. Yen June 2013 – January 2015 Gold Vs. Yen September 2014 – January 2015
SOURCE: BLOOMBERG
SOURCE: SNL METALS & MINING
115000
120000
125000
130000
135000
140000
145000
150000
155000
6/3/2013 9/3/2013 12/3/2013 3/3/2014 6/3/2014 9/3/2014 12/3/2014
125000
130000
135000
140000
145000
150000
155000
9/1/14 10/1/14 11/1/14 12/1/14 1/1/15

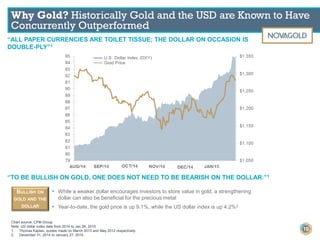

Why Gold? Historically Gold and the USD are Known to Have
Concurrently Outperformed
10
Chart source: CPM Group.
Note: US dollar index data from 2014 to Jan 26, 2015.
1. Thomas Kaplan, quotes made on March 2013 and May 2012 respectively.
2. December 31, 2014 to January 27, 2015.
“ALL PAPER CURRENCIES ARE TOILET TISSUE; THE DOLLAR ON OCCASION IS
DOUBLE-PLY”1
“TO BE BULLISH ON GOLD, ONE DOES NOT NEED TO BE BEARISH ON THE DOLLAR.”1
• While a weaker dollar encourages investors to store value in gold, a strengthening
dollar can also be beneficial for the precious metal
• Year-to-date, the gold price is up 9.1%, while the US dollar index is up 4.2%2
BULLISH ON
GOLD AND THE
DOLLAR

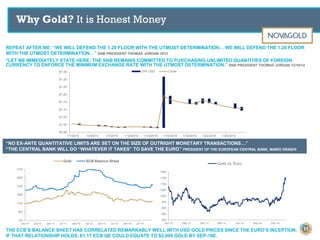

Why Gold? It is Honest Money
THE ECB’S BALANCE SHEET HAS CORRELATED REMARKABLY WELL WITH USD GOLD PRICES SINCE THE EURO’S INCEPTION;
IF THAT RELATIONSHIP HOLDS, €1.1T ECB QE COULD EQUATE TO $2,000 GOLD BY SEP-16E.
100
600
1100
1600
2100
2600
3100
Jan-10 Jul-10 Jan-11 Jul-11 Jan-12 Jul-12 Jan-13 Jul-13 Jan-14 Jul-14
Gold ECB Balance Sheet
800
850
900
950
1000
1050
1100
1150
1200
Jun-13 Sep-13 Dec-13 Mar-14 Jun-14 Sep-14 Dec-14
Gold vs. Euro
“NO EX-ANTE QUANTITATIVE LIMITS ARE SET ON THE SIZE OF OUTRIGHT MONETARY TRANSACTIONS…”
“THE CENTRAL BANK WILL DO “WHATEVER IT TAKES” TO SAVE THE EURO” PRESIDENT OF THE EUROPEAN CENTRAL BANK, MARIO DRAGHI
REPEAT AFTER ME: “WE WILL DEFEND THE 1.20 FLOOR WITH THE UTMOST DETERMINATION… WE WILL DEFEND THE 1.20 FLOOR
WITH THE UTMOST DETERMINATION…” SNB PRESIDENT THOMAS JORDAN 2012
"LET ME IMMEDIATELY STATE HERE: THE SNB REMAINS COMMITTED TO PURCHASING UNLIMITED QUANTITIES OF FOREIGN
CURRENCY TO ENFORCE THE MINIMUM EXCHANGE RATE WITH THE UTMOST DETERMINATION.” SNB PRESIDENT THOMAS JORDAN 12/18/14
$0.95
$1.00
$1.05
$1.10
$1.15
$1.20
$1.25
$1.30
$1.35
1/1/2015 1/4/2015 1/7/2015 1/10/2015 1/13/2015 1/16/2015 1/19/2015 1/22/2015 1/25/2015
CHF USD Close
11

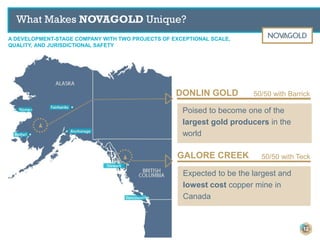

What Makes NOVAGOLD Unique?
Poised to become one of the
largest gold producers in the
world
DONLIN GOLD
GALORE CREEK
Expected to be the largest and
lowest cost copper mine in
Canada
50/50 with Barrick
50/50 with Teck
A DEVELOPMENT-STAGE COMPANY WITH TWO PROJECTS OF EXCEPTIONAL SCALE,
QUALITY, AND JURISDICTIONAL SAFETY
12
Notes:
1) Shown on 100% project basis, of which NOVAGOLD holds a 50% interest
2) Measured and indicated resources inclusive of proven and probable reserves.
See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource
Base” with footnotes in the appendix.

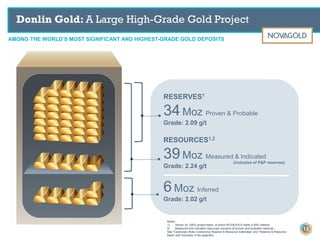

RESERVES1
34Moz Proven & Probable
Grade: 2.09 g/t
RESOURCES1,2
39Moz Measured & Indicated
Grade: 2.24 g/t
6Moz Inferred
Grade: 2.02 g/t
(inclusive of P&P reserves)
AMONG THE WORLD’S MOST SIGNIFICANT AND HIGHEST-GRADE GOLD DEPOSITS
13

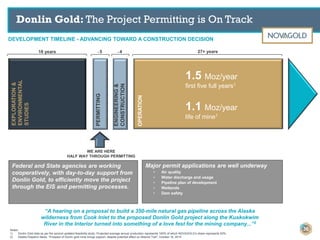

Donlin Gold: A Large High-Grade Gold Project
ARGUABLY THE MOST IMPORTANT GOLD PROJECT IN THE WORLD TODAY
partnerships grade
growthjurisdiction
size
DONLIN GOLD
longevity
leverage to gold 14
Donlin Gold: The Right Project
A REMARKABLE RESOURCE AMONG EMERGING OPEN-PIT GOLD DEPOSITS

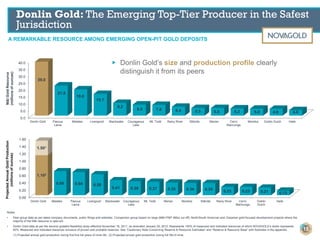

Donlin Gold: The Emerging Top-Tier Producer in the Safest
Jurisdiction
0.00
0.20
0.40
0.60
0.80
1.00
1.20
1.40
1.60
Donlin Gold Metates Pascua
Lama
Livengood Blackwater Courageous
Lake
Mt. Todd Merian Morelos Stibnite Rainy River Cerro
Maricunga
Dublin
Gulch
Haile
1.102
0.66 0.64 0.58
0.41 0.39 0.37 0.35 0.34 0.34 0.23 0.23 0.21 0.13
1.501
ProjectedAnnualGoldProduction
(millionsofounces)
Notes:
• Peer group data as per latest company documents, public filings and websites. Comparison group based on large (M&I+P&P 4Moz cut off), North/South American and Oceanian gold-focused development projects where the
majority of the M&I resource is open-pit.
• Donlin Gold data as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. Represents 100% of measured and indicated resources of which NOVAGOLD’s share represents
50%. Measured and indicated resources inclusive of proven and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix.
(1) Projected annual gold production during first five full years of mine life; (2) Projected annual gold production during full life of mine.
0.0
5.0
10.0
15.0
20.0
25.0
30.0
35.0
40.0
Donlin Gold Pascua
Lama
Metates Livengood Blackwater Courageous
Lake
Mt. Todd Rainy River Stibnite Merian Cerro
Maricunga
Morelos Dublin Gulch Haile
39.0
21.8
19.0
15.7
9.2
8.0 7.8 6.4 5.5 5.5 5.2 5.0 4.9 4.0
M&IGoldResource
(millionsofounces)
▶ Donlin Gold’s size and production profile clearly
distinguish it from its peers
15
Notes:
Donlin Gold projected annual production represents 100% of which NOVAGOLD’s share is 50%. All other production estimates, with the exception of Goldstrike and Pueblo Viejo, are based on published
2014 annual gold production sourced from SNL Metals & Mining. Muruntau 2014 production sourced from Mineweb, Metals Focus. Excludes Newmont’s Nevada Operations and Kloof/Diefontein Complex that
consist of multiple mines. Analysis includes life of mine data for Donlin Gold.
1) Goldstrike and Pueblo Viejo represents the published 2015 gold production guidance.
2) If put into production as contemplated by the second updated feasibility study effective November 18, 2011, as amended January 20, 2012.
151 MINES
>100 Koz
19 MINES
>500 Koz
2 MINES
>800 Koz
5 MINES/
Projects
>1 Moz
GOLDSTRIKE1
USA
DONLIN GOLD
USA
▸ 1.5 Moz/year in first five full years2
▸ 1.1 Moz/year LOM1
GRASBERG
Indonesia
1
Only undeveloped
asset in this category in
North America

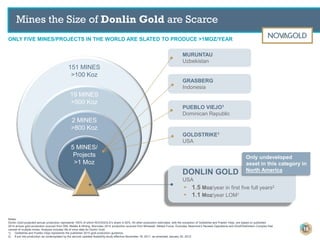

Mines the Size of Donlin Gold are Scarce
ONLY FIVE MINES/PROJECTS IN THE WORLD ARE SLATED TO PRODUCE >1MOZ/YEAR
16
PUEBLO VIEJO1
Dominican Republic
MURUNTAU
Uzbekistan
Donlin Gold: The Right Project
HIGH-GRADE OPEN-PIT MINE
partnerships grade
growthjurisdiction
size
DONLIN GOLD
longevity
leverage to gold 17
Notes:
See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix.
1) Average grade of all deposits globally over 1 Moz in size, sourced from “2013 Global Gold Mine and Deposit Rankings” – Natural Resource Holdings and Visual Capitalist.
2) Donlin Gold data as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. Represents 100% of measured and indicated resources of which NOVAGOLD’s share is 50%.
Measured and indicated resources are inclusive of proven and probable reserves.
World
Avg. Grade1:
1.01 g/t
Donlin Gold
Avg. Grade2:
2.24 g/t
Reserve grades continue to decline while
sources for emerging production to replace
mined-out capacity have become
increasingly scarce
DONLIN GOLD’S HIGH GRADE ENDOWMENT PROVIDES RESILIENCE TO GOLD PRICE CYCLES

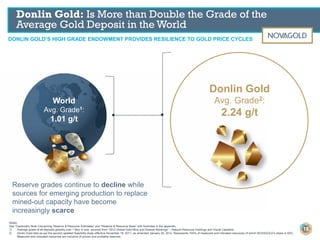

Donlin Gold: Is More than Double the Grade of the
Average Gold Deposit in the World
18
Donlin Gold: The Right Project
SUBSTANTIAL EXPLORATION POTENTIAL
partnerships grade
growthjurisdiction
longevity
leverage to gold
size
DONLIN GOLD
19
MULTIPLE DRILL PROSPECTS AND TARGETS EXIST ALONG 8KM TREND
Donlin Gold: Excellent Exploration Potential
20
The next big gold discovery?
▶ Potential to expand current open-pit
resources along strike and at depth
▶ Good prospects to discover meaningful
deposits outside current mine footprint
• Reserves and resources are
contained within just 3 km of an 8 km
long trend
▶ Inferred mineral resource: 6 Moz of gold
mainly inside the reserve pit
• Upside potential to project economics
▶ In-pit area covers 1,600 acres (~2%) of
the 80,000 acres comprising the entire
land package
Donlin Gold: Reserve & Resource Growth
Notes:
Donlin Gold data as per NOVAGOLD public documents. Represents 100% of measured and indicated resources of which NOVAGOLD’s share represents 50%. Measured and indicated resources are inclusive of proven
and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix.
2006
~17 Moz
2011
39 Moz
Expansion
Potential
OVER FIVE YEARS RESOURCES INCREASED 135%
21
Donlin Gold: The Right Project
27-YEAR MINE LIFE; STRONG LEVERAGE TO GOLD PRICE
partnerships grade
growthjurisdiction
longevity
leverage to gold
size
DONLIN GOLD
22
0
5,000
10,000
15,000
20,000
25,000
30,000
1,200 1,300 1,500 1,700 2,000 2,500
6.2B
8.2B
11.6B
14.6B
19.2B
27.0B
NPV(US$inmillions)
Gold Price (US$)
NPV INCREASES ~20X WITH ~2X INCREASE IN GOLD PRICE

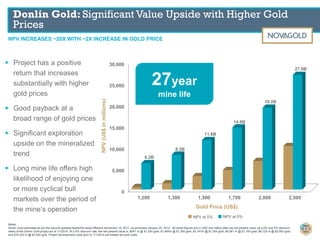

Donlin Gold: Significant Value Upside with Higher Gold
Prices
23
Notes:
Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012 . All dollar figures are in USD and reflect after-tax net present value (at a 0% and 5% discount
rates) of the Donlin Gold project as of 1/1/2014. At a 5% discount rate, the net present value is: $547 m @ $1,200 gold; $1,465m @ $1,300 gold; $3,147m @ $1,500 gold; $4,581 m @ $1,700 gold; $6,722 m @ $2,000 gold;
and $10,243 m @ $2,500 gold. Project development costs prior to 1/1/2014 are treated as sunk costs.
27year
mine life
NPV at 0%NPV at 5%
▶ Project has a positive
return that increases
substantially with higher
gold prices
▶ Good payback at a
broad range of gold prices
▶ Significant exploration
upside on the mineralized
trend
▶ Long mine life offers high
likelihood of enjoying one
or more cyclical bull
markets over the period of
the mine’s operation

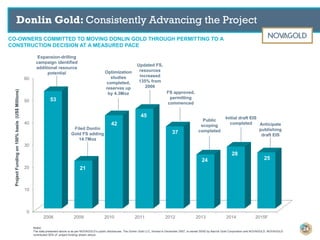

Donlin Gold: Consistently Advancing the Project
0
10
20
30
40
50
60
2008 2009 2010 2011 2012 2013 2014 2015F
53
21
42
45
37
24
28
25
CO-OWNERS COMMITTED TO MOVING DONLIN GOLD THROUGH PERMITTING TO A
CONSTRUCTION DECISION AT A MEASURED PACE
24
ProjectFundingon100%basis(US$Millions)
Notes:
The data presented above is as per NOVAGOLD’s public disclosures. The Donlin Gold LLC, formed in December 2007, is owned 50/50 by Barrick Gold Corporation and NOVAGOLD. NOVAGOLD
contributed 50% of project funding shown above.
Filed Donlin
Gold FS adding
14.7Moz
Optimization
studies
completed,
reserves up
by 4.3Moz
Updated FS,
resources
increased
135% from
2006
FS approved,
permitting
commenced
Initial draft EIS
completed Anticipate
publishing
draft EIS
Expansion-drilling
campaign identified
additional resource
potential
Public
scoping
completed
Notes:
Data sourced from SNL Metals & Mining.
1) Based on announced mining startup dates. Expansions and mine redevelopments are not included as they are not comparable with new mine developments.
27 mines
~8 years
discovery to production
57 mines
111 mines
~11 years
discovery to production
~18 years
discovery to production
0
5
10
15
20
25
30
35
1985
1986
1987
1988
1989
1990
1991
1992
1993
1994
1995
1996
1997
1998
1999
2000
2001
2002
2003
2004
2005
2006
2007
2008
2009
2010
2011
2012
2013
AverageNumberofYearsfromDiscoverytoProduction
Startup Year
▸ Donlin Gold is more than halfway through permitting & will be ready
for a construction decision when sentiment returns
DEVELOPMENT TIMELINE OF NEW GOLD PROJECTS HAS MORE THAN DOUBLED
Keeping to our Timetable:
Project Progressing as Forecasted
25
0
2
4
6
8
10
12
14
16
0
1,000
2,000
3,000
4,000
5,000
6,000
7,000
8,000
9,000
10,000
1997 1999 2001 2003 2005 2007 2009 2011 2013
Notes:
Data as per SNL MEG’s MineSearch database, Company reports, SNL MEG estimates. Thomson Reuters. A gold discovery of 5 Moz or more is considered substantial. Number of discoveries data not yet available for 2014.
NumberofGoldDiscoveries
Gold Discovered
Exploration Budget (US$M)
2012
highest year on
record for
exploration
spending and first
year in over two
decades with no
discoveries
DESPITE RECORD HIGH EXPLORATION SPENDING LEVELS THE GOLD INDUSTRY HAS
EXPERIENCED A RECENT DROP IN DISCOVERIES
Why Donlin Gold? No New Substantial Discoveries
26
LOCATED IN ALASKA, ONE OF THE TRULY SAFE MINING JURISDICTIONS
Donlin Gold: The Right Project
partnerships grade
growthjurisdiction
size
DONLIN GOLD
longevity
leverage to gold 27
JURISDICTIONAL APPEAL IS COMPRISED OF FIVE CORNERSTONES:
1) MINERAL POTENTIAL
2) ESTABLISHED MINING PRACTICE
3) POLITICAL AND SOCIAL STABILITY
4) EXCELLENT LOCAL PARTNERSHIPS AND, OF “EXISTENTIAL IMPORTANCE”...
5) A FULL EMBRACE OF THE RULE OF LAW

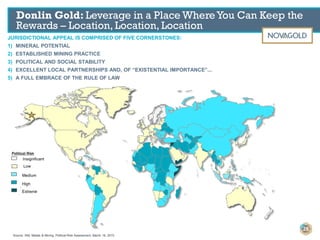

Donlin Gold: Leverage in a Place WhereYou Can Keep the
Rewards – Location, Location, Location
28
Political Risk
Insignificant
Low
Medium
High
Extreme
Source: SNL Metals & Mining, Political Risk Assessment, March 16, 2015

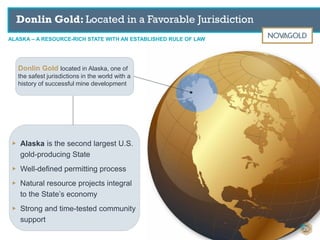

Donlin Gold located in Alaska, one of
the safest jurisdictions in the world with a
history of successful mine development
▶ Alaska is the second largest U.S.
gold-producing State
▶ Well-defined permitting process
▶ Natural resource projects integral
to the State’s economy
▶ Strong and time-tested community
support
ALASKA – A RESOURCE-RICH STATE WITH AN ESTABLISHED RULE OF LAW
Donlin Gold: Located in a Favorable Jurisdiction
2929
STRONG PARTNERSHIPS
Donlin Gold: The Right Project
partnerships grade
growthjurisdiction
size
DONLIN GOLD
longevity
leverage to gold 30
Barrick Gold Fourth Quarter 2014 Results – Full Donlin Gold Disclosure
“The 50% owned Donlin Gold project located in Alaska is one of the largest undeveloped gold deposits in the
world. In terms of size, grade, and jurisdictional safety, Donlin Gold is an excellent asset in Barrick's portfolio
with significant leverage to the price of gold. The Donlin Gold project has approximately 39 million ounces of
contained gold (100% basis) in the measured and indicated resource categories (approximately 8 million
tonnes grading 2.52 g/t (measured) and 533 million tonnes grading 2.24 g/t (indicated)). In addition to its
already large mineral endowment, the project also has exploration potential which could expand the current
open pit resource.
Under our disciplined capital allocation framework, we have continued to work with our partner, Novagold
Resources, to advance the Donlin Gold project. Current activities, by which we maintain and enhance the
option value of this project at a modest cost, are focused on permitting, community outreach and workforce
development. In 2014, Donlin Gold secured long-term surface use rights and significantly advanced the
permitting of the Donlin Gold project which is now about halfway complete.
Barrick is working closely with its partner on alternatives designed to minimize initial capital outlay. The
outcome of that effort may include engagement of third party operators and exploring possibilities for third
party financing of some capital intensive infrastructure. Collectively, we are also investing about $3 million
(100% basis) on technical studies to identify potential design and execution enhancements. Donlin Gold has
substantial leverage to gold prices and has the potential to add significant value to Barrick and its future
growth pipeline in a higher gold price environment. Any decision to proceed with development, either as
currently envisaged, or in an optimized scenario, will depend on the project meeting Barrick's minimum
hurdle rate which will depend in large part on the prevailing gold prices and market conditions.”
Donlin Gold: Perfect Alignment between Partners
31
Notes:
As per Barrick Gold’s Fourth Quarter and Full Year 2014 Results disclosed on February 18, 2015.
COLLABORATING WITH OUR PARTNER TO MAXIMIZE PROJECT RETURN
Donlin Gold: Partnerships & Activities
Barrick and NOVAGOLD are jointly committed to working together to create
shareholder value from Donlin Gold’s unique optionality
▶ Project activities continue to progress as planned
▶ After further de-risking, we are encouraged by Donlin Gold’s prospects
▶ Focused on advancing Donlin Gold through permitting to a record of decision
▶ Working together with Barrick to evaluate development scenarios
▶ Neither partner has a build at any gold price mentality
“Both companies are happy to take a sober and constructive view. We don't
want to subsidize the world's consumption of gold by squandering the treasures
that Mother Nature has given us and we're happy to wait for the higher gold
prices that will make the project's economics sing.”
– Thomas S. Kaplan, Chairman of NOVAGOLD
RETAINING THE GREATEST VALUE WHILE ENSURING CAPITAL EFFICIENCY
32
Donlin Gold: Mining with the Local Communities
ALASKA NATIVE CORPORATIONS: LEADERS OF REGIONAL ECONOMIC DEVELOPMENT
33
▶ ANCSA established 40 years ago; resolved
legal issues related to Native land claims
▶ Lands valuable for resource potential
selected by Regional Corporations under
ANCSA
▶ Native corporations have an owner’s
interest in the development of the selected
lands to support the economic prosperity of
their shareholders
▶ Mining is compatible and consistent with
subsistence lifestyles
▶ Donlin Gold is located on private land
specifically selected for its resource
development potential
33
Donlin Gold has the support of the land owners through a 20+ year relationship
“Calista and TKC are not only stakeholders, but are
the legislatively mandated landowners charged
with the responsibility of seeing the project to
fruition in an environmentally responsible manner.”
– June MacAtee, Vice President of Calista Corporation
(mineral owner)
"Since 1995, Donlin Gold has worked constructively in
our region and I know our partnership will benefit our
shareholders for many generations. Today's agreement
sets the basis for a long and productive relationship
that with construction of the mine will provide jobs and
financial value to the shareholders in our 10 villages.”
– Maver Carey, President & CEO of
The Kuskokwim Corporation (surface owner)
STRONG AND TIME-HONORED RELATIONSHIPS WITH STAKEHOLDERS
Donlin Gold: Durable, Long-Term Agreements with the
Native Corporations
3434
“We, the Board members of NOVAGOLD, are truly
proud of the fact that our company and NFWF
have come together to create an extraordinary
partnership that can serve as a model for the
sustainable development of natural resources.”
Thomas Kaplan, Chairman
“The lands and waters of Alaska provide a home for
an incredible number of fish and wildlife species.
We applaud this commitment from NOVAGOLD and
Donlin Gold as a significant contribution toward
conserving the wetlands, streams and wild places of
Alaska for future generations.”
Jeff Trandahl, Executive Director & CEO
The partnership supports regional
solutions driven by locals to:
▶ Promote healthy watersheds
▶ Enhance and protect wildlife habitat
▶ Advance sustainable fisheries
PROTECT, RESTORE AND CONSERVE ALASKA FISH AND WILDLIFE
Donlin Gold: A Unique Partnership with the National Fish
and Wildlife Foundation (NFWF)
35
DEVELOPMENT TIMELINE - ADVANCING TOWARD A CONSTRUCTION DECISION
Donlin Gold: The Project Permitting is On Track
16 years ̴ 4 27+ years
EXPLORATION&
ENVIRONMENTAL
STUDIES
PERMITTING
ENGINEERING&
CONSTRUCTION
OPERATION
WE ARE HERE
HALF WAY THROUGH PERMITTING
1.5 Moz/year
first five full years1
1.1 Moz/year
life of mine1
̴ 5
Notes:
1) Donlin Gold data as per the second updated feasibility study. Projected average annual production represents 100% of which NOVAGOLD’s share represents 50%.
2) Alaska Dispatch News, “Prospect of Donlin gold mine brings support, despite potential effect on Iditarod Trail”, October 16, 2014
Federal and State agencies are working
cooperatively, with day-to-day support from
Donlin Gold, to efficiently move the project
through the EIS and permitting processes.
Major permit applications are well underway
• Air quality
• Water discharge and usage
• Pipeline plan of development
• Wetlands
• Dam safety
36
“A hearing on a proposal to build a 350-mile natural gas pipeline across the Alaska
wilderness from Cook Inlet to the proposed Donlin Gold project along the Kuskokwim
River in the Interior turned into something of a love fest for the mining company...”2
Notice of Intent
to Prepare EIS
Draft EIS Final EIS
Record of Decision
Initial permit applications
Submitted: 08/12
Notice of intent
Issued: 12/14/12
Public scoping period
Ended: 03/29/13
Scoping summary document
Completed: 08/13
Development of alternatives
Completed: Q2/14
Initial drafts of EIS chapters
Completed: Q4/14
Agency & Donlin Gold review
Completed: Q4/14
Prepare draft EIS
Publish draft EIS
Public comment period
Prepare draft final EIS
Agency review
Publish final EIS
Record of decision
2012-2013 2013-2016 2016-2017
PAST THE HALFWAY MARK IN THE EIS PROCESS
Donlin Gold: Permitting Milestones
37
COLLABORATING WITH OUR PARTNER TO MAXIMIZE PROJECT RETURN
Donlin Gold: Optimization Studies
38
▶ Optimization studies underway to evaluate opportunities to reduce initial owner capital
• Third-party financing or owner/operator prospects (≈$1.0B potential reductions i.e. gas
pipeline, port facilities, oxygen plant, mining fleet)
• Conducting technical studies ($3.0M) with experts from both companies and independent
consultants to identify potential design and execution enhancements from FSU2
Potential benefits:
▶ Lower initial owner capital required to build
▶ Opportunity to implement lessons learned from past/current experience in building and
operating assets such as Pueblo Viejo
▶ Opportunity to expand with future cash-flow generation
▶ When sentiment returns in the gold sector, the market will seek out projects with leverage
and growth
THE KIND OF ASSET YOU CAN BUILD A COMPANY AROUND
Galore Creek: A Significant Copper-Gold-Silver Asset in
Canada
Notes:
1) Represents 100% of measured and indicated resources of which NOVAGOLD’s share is
50%. Measured and indicated resources inclusive of proven and probable reserves.
See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource
Base” with footnotes in the appendix.
9Blbs
Grade: 0.50%
8Moz
Grade: 0.31 g/t
136 Moz
Grade: 5.21 g/t
copper
gold
silver
M&I Resources1
39

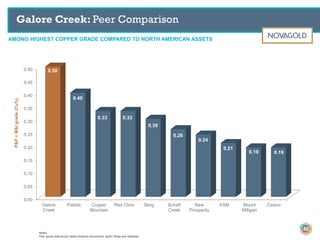

0.00
0.05
0.10
0.15
0.20
0.25
0.30
0.35
0.40
0.45
0.50
Galore
Creek
Pebble Copper
Mountain
Red Chris Berg Schaft
Creek
New
Prosperity
KSM Mount
Milligan
Casino
0.50
0.40
0.33 0.33
0.30
0.26
0.24
0.21
0.19 0.19
AMONG HIGHEST COPPER GRADE COMPARED TO NORTH AMERICAN ASSETS
Galore Creek: Peer ComparisonP&P+M&Igrade(Cu%)
Notes:
Peer group data as per latest company documents, public filings and websites.
40

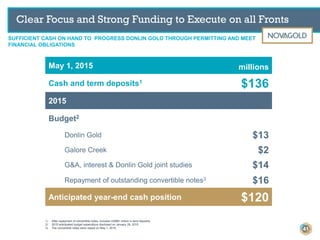

May 1, 2015 millions
Cash and term deposits1
$136
2015
Budget2
Donlin Gold $13
Galore Creek $2
G&A, interest & Donlin Gold joint studies $14
Repayment of outstanding convertible notes3
$16
Anticipated year-end cash position $120
1) After repayment of convertible notes, includes US$85 million in term deposits.
2) 2015 anticipated budget expenditure disclosed on January 28, 2015.
3) The convertible notes were repaid on May 1, 2015.
SUFFICIENT CASH ON HAND TO PROGRESS DONLIN GOLD THROUGH PERMITTING AND MEET
FINANCIAL OBLIGATIONS
Clear Focus and Strong Funding to Execute on all Fronts
41
CONTINUE TO EXECUTE AND DELIVER ON OUR BUSINESS PLAN
2015 Outlook
1 2 3 4 5
PRIORITY PRIORITY PRIORITY PRIORITY PRIORITY
Advance
Donlin Gold
permitting
to a
construction
decision
Advance
Galore Creek
mine
planning
and project
design
Evaluate
opportunities
to monetize
the value of
Galore Creek
Safeguard
our cash
position
Maintain
strong
relationships
with all
stakeholders
COMMITTED TO GOLD THROUGH VARIOUS
MARKET CYCLES 42
26.7%
11.3%
6.9%
5.2%3.0%
47%
A BLUE CHIP INSTITUTIONAL QUALITY INVESTMENT
Why Invest in NOVAGOLD?
Held by top
5 shareholders1
53%
Electrum Strategic
Resources LP
Paulson & Co. Inc
The Baupost
Group, L.L.C.
Van Eck Associates
Corporation
Tocqueville Asset
Management
Other
Market Cap3
$1.3B
Cash and Term
Deposits2
$136M
1) Shareholder positions are based on the latest 13-F filings
2) Includes $85 million in term deposits as of May 1, 2015.
3) Market Capitalization as of May 20, 2015 based on 317.8
million shares issued and outstanding and NG share
price of $4.12.
NYSE-MKT, TSX: NG
43
NOVAGOLD
focused on execution and
delivery of our business plan
NOVAGOLD Highlights
Safe Geo-Political Environment:
Alaska and British Columbia,
top-rated mining jurisdictions
Accomplished Team:
185 years cumulative
experience
Prolific Production Profile:
Donlin Gold expected to be one of industry’s
top producing assets; strong leverage to gold
Supportive Stakeholders:
Long standing shareholders and
engaged partners
Strong Balance Sheet:
$136m cash + term deposits
as of May 1, 2015
Top Tier Assets:
Donlin Gold: Large, high-
grade deposit past 50%
mark in permitting; great
additional exploration
potential
44
novagold.com
Appendix
ADVANCING DONLIN GOLD UP THE VALUE CHAIN
Donlin Gold: A Project Overview
46
▶ Donlin Gold LLC is the operating company
▶ 50/50 ownership by NOVAGOLD and Barrick Gold
▶ Board of Directors has two representatives from each company
• Chairman rotates every year
• Each company has the right to appoint the Donlin Gold General Manager every two years
▶ Operates under agreements with Alaska Native Claims Settlement Act (ANCSA) landowners
• Calista Corporation (Subsurface minerals and surface lease)
• The Kuskokwim Corporation (Surface use agreement)
▶ Project office in Anchorage
• 22 full-time employees and 4 contractors
▶ Strong track record for local hiring
DONLIN GOLD SLATED TO BE A STATE-OF-THE-ART SIGNIFICANT MINE
Donlin Gold: Project Highlights
Reserves: 33.9 Moz Au (505M tonnes ore)1
Resources: 5.1 Moz M&I (excluding P&P) and 6.0 Moz Inferred1
Mine Life: ~27 years
Production: Year 1-5,1.5 Moz/year; LOM,1.1 Moz/year
Operation: Open-pit, conventional truck & shovel
Milling: 53.5k tonnes/day, sulfide flotation, pressure
oxidation (POX), carbon-in-leach recovery (CIL)
Strip ratio: 5.5 = 2.8B tonnes waste rock
Tailings: Fully lined storage facility
Power: 153MW average site-generated load, fueled by natural gas
transported via a 315-mile pipeline
Logistics: All consumables supplied by Kuskokwim River transportation
system with port near Jungjuk Creek
See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve and Resource Base” table with footnotes.
47

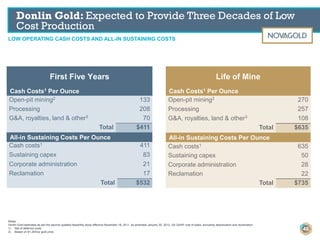

Donlin Gold: Expected to Provide Three Decades of Low
Cost Production
LOW OPERATING CASH COSTS AND ALL-IN SUSTAINING COSTS
Open-pit mining2 270
Processing 257
G&A, royalties, land & other3 108
Total $635
Open-pit mining2 133
Processing 208
G&A, royalties, land & other3 70
Total $411
Cash Costs1 Per Ounce
First Five Years
Notes:
Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. US GAAP cost of sales, excluding depreciation and reclamation
1) Net of deferred costs
2) Based on $1,200/oz gold price
All-in Sustaining Costs Per Ounce
Cash costs1 635
Sustaining capex 50
Corporate administration 28
Reclamation 22
Total $735
Cash costs1 411
Sustaining capex 83
Corporate administration 21
Reclamation 17
Total $532
Life of Mine
Cash Costs1 Per Ounce
All-in Sustaining Costs Per Ounce
48

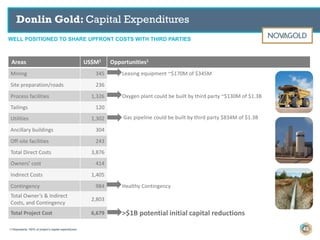

WELL POSITIONED TO SHARE UPFRONT COSTS WITH THIRD PARTIES
Donlin Gold: Capital Expenditures
Areas US$M1 Opportunities1
Mining 345 Leasing equipment ~$170M of $345M
Site preparation/roads 236
Process facilities 1,326 Oxygen plant could be built by third party ~$130M of $1.3B
Tailings 120
Utilities 1,302
Ancillary buildings 304
Off-site facilities 243
Total Direct Costs 3,876
Owners’ cost 414
Indirect Costs 1,405
Contingency 984 Healthy Contingency
Total Owner’s & Indirect
Costs, and Contingency
2,803
Total Project Cost 6,679 >$1B potential initial capital reductions
Gas pipeline could be built by third party $834M of $1.3B
1) Represents 100% of project’s capital expenditures 49
ROBUST ECONOMICS HIGHLY LEVERAGED TO GOLD PRICES
Donlin Gold: Key Performance Indicators
Gold Price
Unit $1,200/oz
Base Case
$1,500/oz $1,700/oz $2,000/oz $2,500/oz
Average annual
after-tax cash flow
(first full five years)
$M 950 1,306 1,500 1,785 2,185
Average annual
after-tax cash flow (LOM)
$M 500 704 815 990 1,275
NPV (5%) after-tax1 $M 550 3,147 4,580 6,720 10,240
NPV (0%) after-tax1 $M 6,200 11,631 14,620 19,250 26,975
IRR after-tax1 % 6.0 10.2 12.3 15.1 19.1
Payback period Years 9.2 6.1 5.3 4.4 3.5
Notes:
Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. All dollar figures are in USD and reflect after-tax net present value (at a 0% and 5% discount
rates) of the Donlin Gold Project as of 1/1/2014 per the feasibility study timeline. Project development costs prior to that date are treated as sunk costs.
All amounts in US dollars
1) NPVs and IRRs as at January 1, 2014. Project development costs prior to that date are treated as sunk costs.
50
LARGE PROJECTS HAVE BEEN SUCCESSFULLY PERMITTED
Donlin Gold: Permitting in the U.S.

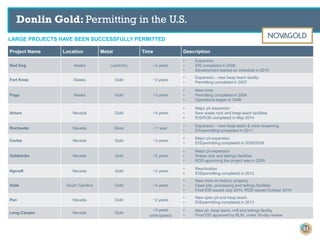

Project Name Location Metal Time Description
Red Dog Alaska Lead/zinc ~2 years
• Expansion
• EIS completed in 2009
• Development started on schedule in 2010
Fort Knox Alaska Gold ~3 years
• Expansion – new heap leach facility
• Permitting completed in 2007
Pogo Alaska Gold ~3 years
• New mine
• Permitting completed in 2004
• Operations began in 2006
Arturo Nevada Gold ~4 years
• Major pit expansion
• New waste rock and heap leach facilities
• EIS/ROD completed in May 2014
Rochester Nevada Silver ~1 year
• Expansion – new heap leach & mine reopening
• EA/permitting completed in 2011
Cortez Nevada Gold ~3 years
• Major pit expansion
• EIS/permitting completed in 2008/2009
Goldstrike Nevada Gold ~2 years
• Major pit expansion
• Waste rock and tailings facilities
• ROD approving the project was in 2009
Hycroft Nevada Gold ~2 years
• Reactivation
• EIS/permitting completed in 2012
Haile South Carolina Gold ~4 years
• New mine on historic property
• Open pits, processing and tailings facilities
• Final EIS issued July 2014, ROD issued October 2014
Pan Nevada Gold ~2 years
• New open pit and heap leach
• EIS/permitting completed in 2013
Long Canyon Nevada Gold
~3 years
(anticipated)
• New pit, heap leach, mill and tailings facility
• Final EIS approved by BLM, under 30-day review
51
GALORE CREEK, AN EXCEPTIONAL ASSET
Galore Creek: Project Overview
52
▶ Galore Creek Mining Corporation (GCMC) is the operating company
▶ 50/50 ownership by NOVAGOLD and Teck Resources Inc.
▶ Management Committee has two representatives from each company
• Chairman rotates every year
▶ Project is located within the Tahltan Nation Territory and operates under a Participation
Agreement
▶ All mineral claims are on Crown land
▶ Project office in Vancouver
• Abundance of technical strength to draw from within Teck
▶ Strong track record for Tahltan hiring at project site as well as contracting and procurement
with Tahltan businesses and joint ventures
GALORE CREEK TO BE ONE OF CANADA’S LARGEST COPPER MINES
Galore Creek: Project Highlights
Reserves: 6.8 Blb Cu; 5.5 Moz Au; 102 Moz Ag1
Resources: 8.9 Blb Cu; 8.0 Moz Au; 136 Moz Ag (inclusive of reserves)1
Mine Life: ~18 years
Production: Year 1-5, 400 Mlb/year Cu; LOM, 340 Mlb/year Cu
Cash costs: LOM, $0.80/lb Cu at base case assumptions2
Operation: Open-pit, conventional truck & shovel
Milling: +80k tonnes/day, conventional crush, grind, and Cu/Au/Ag flotation
concentration, plant located in West More Valley
Strip ratio: 2.2 = 1.1B tonnes waste rock
Tailings: storage facility located in West More Valley next to plant
Power: BC Hydro’s Northwest Transmission Line is now in service
connecting from near Terrace, BC to Bob Quinn to promote remote
industrial development, Galore Creek to tie into the NTL
Logistics: Port facilities to be built near Stewart, BC
Notes:
1) See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve and Resource Base” table with footnotes.
2) Base Price Case metal prices are US$2.65/lb Cu, US$1,100/oz Au and US$18.50 Ag and foreign exchange rate of 1.11 CAD/USD.
53
ROBUST ECONOMICS HIGHLY LEVERAGED TO METAL PRICES
Galore Creek: Key Performance Indicators
Unit Metal Prices
Copper
Gold
Silver
US$/lb
US$/oz
US$/oz
2.00
900
15.00
2.65
1,100
18.50
3.00
1,100
20.00
3.50
1,200
25.00
4.00
1,300
30.00
LOM after-tax cash flow $M 1,514 5,118 6,641 9,223 11,812
NPV (5%) after-tax1 $M (969) 988 1,794 3,134 4,458
NPV (7%) after-tax1 $M (1,431) 137 778 1,837 2,877
IRR after-tax1 % 2.4 7.4 9.2 11.9 14.3
Payback period Years 13.2 7.8 6.1 4.1 3.3
Notes:
Galore Creek estimates as per the 2011 Pre-Feasibility Study. All dollar figures are in CAD. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix.
1) NPVs and IRRs as of two years prior to significant project spend. Project development costs prior to that point are treated as sunk costs.
All amounts in CAD dollars
54
NOVAGOLD: The Management Team
Gregory Lang
President & CEO
▸ Former President of Barrick Gold North America
▸ 35 years experience building & operating major mines
▸ Intimate knowledge of Donlin Gold
David Deisley
Executive Vice President and
General Counsel
▸ Former EVP and General Counsel of Goldcorp
▸ Regional General Counsel for Barrick Gold North America
▸ Extensive track record in project permitting, corporate social responsibility, mergers and
acquisitions and corporate development
▸ 25 years of mining industry experience
David Ottewell
Vice President and Chief
Financial Officer
▸ Former VP and Corporate Controller of Newmont Mining Corporation
▸ 25 years of mining industry experience
▸ Diverse experience in all facets of financial management, from mine operations to
executive corporate financial management of premier gold producers
Mélanie Hennessey
Vice President, Corporate
Communications
▸ Held variety of executive and senior IR & corporate communications positions with
Goldcorp, New Gold, and Hecla Mining Company
▸ Leading NOVAGOLD’s internal and external communications functions
Ron Rimelman
Vice President, Environment,
Health, Safety & Sustainability
▸ 25+ years of environmental experience, managing environmental impact assessments
and permitting activities world-wide
▸ Leadership role on mine permitting and NEPA evaluations for mine projects in Alaska
since 1993
Richard Williams
Vice President, Engineering
and Development
▸ Former Project Director for the Pueblo Viejo project in the Dominican Republic
▸ 30 years of experience developing and operating major mines world-wide
▸ Particular expertise in autoclave technology
INDUSTRY LEADERS TO BRING DONLIN GOLD THROUGH PERMITTING & BEYOND
55
NOVAGOLD: The Board of Directors
Dr. Thomas Kaplan
Chairman
Chairman and CIO of The Electrum Group LLC, a privately held natural resources investor
that controls a diversified portfolio of precious and base metals assets
Sharon Dowdall
Former Chief Legal Officer and Corporate Secretary with Franco-Nevada, transforming an
industry pioneer into one of the most successful precious metals enterprises in the world
Dr. Marc Faber
A well-known commentator and author on global investing, publisher of The Gloom, Boom &
Doom Report
Greg Lang
President & CEO
Former President of Barrick Gold North America, 35 years experience building & operating
major mines with intimate knowledge of Donlin Gold
Gil Leathley
COO and Director of Sunward Resources, former Senior Vice President and Chief Operating
Officer of the Company
Igor Levental
President of The Electrum Group LLC, former VP of Homestake Mining and International
Corona Corp.
Kalidas Madhavpeddi Overseas Chief Executive Officer of China Moly Corp. Former Executive with Phelps Dodge.
Gerald McConnell Former Chairman and CEO of NOVAGOLD, CEO of Namibia Rare Earths Inc.
Clynton Nauman CEO of Alexco Resources, formerly with Viceroy Gold and Kennecott Minerals
Rick Van Nieuwenhuyse CEO of NovaCopper, founder and former CEO of NOVAGOLD
Anthony Walsh
Former President and Chief Executive Officer of Miramar Mining Corporation, which in 2007
was sold to Newmont Mining Corporation.
56
NOVAGOLD: Reserve/Resource Table
57
Donlin Gold (100% basis)* Tonnage Grade Metal content
GOLD Kt g/t Au Koz Au
Reserves1
Proven 7,683 2.32 573
Probable 497,128 2.08 33,276
P&P 504,811 2.09 33,849
Resources3, inclusive of Reserves
Measured 7,731 2.52 626
Indicated 533,607 2.24 38,380
M&I 541,337 2.24 39,007
Inferred 92,216 2.02 5,993
Galore Creek (100% basis)* Tonnage Grade Metal content
COPPER Mt % Cu Blb Cu
Reserves2
Proven 69.0 0.606 0.9
Probable 459.1 0.582 5.9
P&P 528.0 0.585 6.8
Resources4, exclusive of Reserves
Measured 39.5 0.25 0.22
Indicated 247.2 0.34 1.85
M&I 286.7 0.33 2.07
Inferred 346.6 0.42 3.23
GOLD Mt g/t Au Moz Au
Reserves2
Proven 69.0 0.520 1.15
Probable 459.1 0.291 4.30
P&P 528.0 0.321 5.45
Resources4, exclusive of Reserves
Measured 39.5 0.39 0.50
Indicated 247.2 0.26 2.04
M&I 286.7 0.27 2.53
Inferred 346.6 0.24 2.70
SILVER Mt g/t Ag Moz Ag
Reserves2
Proven 69.0 4.94 11.0
Probable 459.1 6.18 91.2
P&P 528.0 6.02 102.1
Resources4, exclusive of Reserves
Measured 39.5 2.58 3.27
Indicated 247.2 3.81 30.26
M&I 286.7 3.64 33.54
Inferred 346.6 4.28 47.73
* Mineral reserves are reported
on a 100% basis. NOVAGOLD and
Barrick each own 50% of the
Donlin Gold project. NOVAGOLD
and Teck each own 50% of the
Galore Creek project.
t = metric tonne
oz = ounce
lb = pound
K = thousand
M = million
B = billion
g/t = grams/tonne
Approximate cut-off grades
(see Resource Footnotes):
Donlin Gold Reserves1: 0.57 g/t gold
Resources3: 0.46 g/t gold
Galore Creek Reserves2: C$10.08 NSR
Resources4: C$10.08 NSR
Notes:
a. These resource estimates have been prepared in accordance with NI43-101 and the CIM Definition Standard, unless otherwise noted.
b. See numbered footnotes below on resource information.
c. Rounding as required by reporting guidelines may result in apparent summation differences between tonnes, grade and contained metal content
d. Tonnage and grade measurements are in metric units. Contained gold and silver ounces are reported as troy ounces, contained copper pounds as imperial pounds
Resource Footnotes:
1) Mineral Reserves are contained within Measured and Indicated pit designs, and supported by a mine plan, featuring variable throughput rates, stockpiling and cut-off optimization. The pit designs and mine plan were optimized on diluted
grades using the following economic and technical parameters: Metal price for gold of US$975/oz; reference mining cost of US$1.67/t incremented US$0.0031/t/m with depth from the 220 m elevation (equates to an average mining cost of
US$2.14/t), variable processing cost based on the formula 2.1874 x (S%) + 10.65 for each US$/t processed; general and administrative cost of US$2.27/t processed; stockpile rehandle costs of US$0.19/t processed assuming that 45% of
mill feed is rehandled; variable recoveries by rock type, ranging from 86.66% in shale to 94.17% in intrusive rocks in the Akivik domain; refining and freight charges of US$1.78/oz gold; royalty considerations of 4.5%; and variable pit slope
angles, ranging from 23º to 43º. Mineral Reserves are reported using an optimized net sales return value based on the following equation: Net Sales Return = Au grade * Recovery * (US$975/oz – (1.78 + (US$975/oz – 1.78) * 0.045)) -
(10.65 + 2.1874 * (S%) + 2.27 + 0.19) and reported in US$/tonne. Assuming an average recovery of 89.54% and an average S% grade of 1.07%, the marginal gold cutoff grade would be approximately 0.57 g/t, or the gold grade that would
equate to a 0.001 NSR cutoff at these same values. The life of mine strip ratio is 5.48. The assumed life-of-mine throughput rate is 53.5 kt/d.
2) Mineral Reserves are contained within Measured and Indicated pit designs using metal prices for copper, gold and silver of US$2.50/lb, US$1,050/oz, and US$16.85/oz, respectively. Appropriate mining costs, processing costs, metal
recoveries and inter ramp pit slope angles varying from 42º to 55º were used to generate the pit phase designs. Mineral Reserves have been calculated using a 'cashflow grade' ($NSR/SAG mill hr) cut-off which was varied from year to year
to optimize NPV. The net smelter return (NSR) was calculated as follows: NSR = Recoverable Revenue – TCRC (on a per tonne basis), where: NSR = Net Smelter Return; TCRC = Transportation and Refining Costs; Recoverable
Revenue = Revenue in Canadian dollars for recoverable copper, recoverable gold, and recoverable silver using metal prices of US$2.50/lb, US$1,050/oz, and US$16.85/oz for copper, gold, and silver, respectively, at an exchange rate of
CDN$1.1 to US$1.0; Cu Recovery = Recovery for copper based on mineral zone and total copper grade; for Mineral Reserves this NSR calculation includes mining dilution. SAG throughputs were modeled by correlation with alteration
types. Cash flow grades were calculated as the product of NSR value in $/t and throughput in t/hr. The life of mine strip ratio is 2.16.
3) Mineral Resources are contained within a conceptual Measured, Indicated and Inferred optimized pit shell using the following assumptions: gold price of US$1,200/oz; variable process cost based on 2.1874 * (sulphur grade) + 10.6485;
administration cost of US$2.29/t; refining, freight & marketing (selling costs) of US$1.85/oz recovered; stockpile rehandle costs of US$0.20/t processed assuming that 45% of mill feed is rehandled; variable royalty rate, based on royalty of
4.5% * (Au price – selling cost). Mineral Resources have been estimated using a constant Net Sales Return cut-off of US$0.001/t milled. The Net Sales Return was calculated using the formula: Net Sales Return = Au grade * Recovery *
(US$1200/oz – (1.85 + ((US$1200/oz – 1.85) * 0.045)) - (10.65 + 2.1874 * (S%) + 2.29 + 0.20)) and reported in US$/tonne. Mineral Resources are inclusive of Mineral Reserves. Mineral Resources that are not Mineral Reserves do not have
demonstrated economic viability. Inferred Resources are in addition to Measured and Indicated Resources. Inferred Resources have a great amount of uncertainty as to their existence and whether they can be mined legally or
economically. It cannot be assumed that all or any part of the Inferred Resources will ever be upgraded to a higher category. See "Cautionary Note Concerning Reserve & Resource Estimates".
4) Mineral resources are contained within a conceptual Measured, Indicated and Inferred optimized pit shell using the same economic and technical parameters as used for Mineral Reserves. Tonnages are assigned based on proportion of
the block below topography. The overburden/bedrock boundary has been assigned on a whole block basis. Mineral resources have been estimated using a constant NSR cut-off of C$10.08/t milled. The Net Smelter Return (NSR) was
calculated as follows: NSR = Recoverable Revenue – TCRC (on a per tonne basis), where: NSR = Diluted Net Smelter Return; TCRC = Transportation and Refining Costs; Recoverable Revenue = Revenue in Canadian dollars for
recoverable copper, recoverable gold, and recoverable silver using silver using the economic and technical parameters mentioned above. The mineral resource includes material within the conceptual M,I&I pit that is not scheduled for
processing in the mine plan but is above cutoff. Mineral Resources are inclusive of Mineral Reserves. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. Inferred Resources are in addition to
Measured and Indicated Resources. Inferred Resources have a great amount of uncertainty as to their existence and whether they can be mined legally or economically. It cannot be assumed that all or any part of the Inferred Resources
will ever be upgraded to a higher category. See "Cautionary Note Concerning Reserve & Resource Estimates".
Cautionary Note Concerning Reserve & Resource Estimates
This summary table uses the term “resources”, “measured resources”, “indicated resources” and “inferred resources”. United States investors are advised that, while such terms are recognized and required by Canadian securities laws, the
United States Securities and Exchange Commission (the “SEC”) does not recognize them. Under United States standards, mineralization may not be classified as a “reserve” unless the determination has been made that the mineralization
could be economically and legally produced or extracted at the time the reserve determination is made. Mineral resources that are not mineral reserves do not have demonstrated economic viability. United States investors are cautioned not to
assume that all or any part of measured or indicated resources will ever be converted into reserves. Further, inferred resources have a great amount of uncertainty as to their existence and as to whether they can be mined legally or
economically. It cannot be assumed that all or any part of the inferred resources will ever be upgraded to a higher category. Therefore, United States investors are also cautioned not to assume that all or any part of the inferred resources
exist, or that they can be mined legally or economically. Disclosure of “contained ounces” is permitted disclosure under Canadian regulations, however, the SEC normally only permits issuers to report “resources” as in place tonnage and
grade without reference to unit measures. Accordingly, information concerning descriptions of mineralization and resources contained in this release may not be comparable to information made public by United States companies subject to
the reporting and disclosure requirements of the SEC.
NI 43-101 is a rule developed by the Canadian Securities Administrators, which established standards for all public disclosure an issuer makes of scientific and technical information concerning mineral projects. Unless otherwise indicated, all
resource estimates contained in this circular have been prepared in accordance with NI 43-101 and the CIM Definition Standards.
Technical Reports and Qualified Persons
The documents referenced below provide supporting technical information for each of NOVAGOLD's projects.
Project Qualified Person(s) Most Recent Disclosure & Filing Date
Donlin Gold Gordon Seibel R.M. SME, AMEC “Donlin Creek Gold Project Alaska, USA, NI 43-101 Technical Report on Second Updated Feasibility Study” effective November 18, 2011, amended January 20, 2012.
Kirk Hanson P.E., AMEC
Galore Creek Jay Melnyk, P.Eng., AMEC “Galore Creek Copper-Gold Project NI 43-101 Technical Report on Pre-Feasibility Study, British Columbia – Canada” effective July 27, 2011.
Greg Kulla, P.Geo., AMEC
Heather White, B.Sc., P.Eng., who is a consultant to NOVAGOLD and a “qualified person” under NI 43-101, has approved the scientific and technical information included in this Reserve and Resource Table.
NOVAGOLD: Reserve/Resource Table (con’t)
58
NOVAGOLD RESOURCES INC.
Suite 720 – 789 West Pender Street
Vancouver, BC
Canada V6C 1H2
T 604 669 6227 TF 1 866 669 6227 F 604 669 6272
www.novagold.com
info@novagold.com
Mélanie Hennessey
VP, Corporate Communications
melanie.hennessey@novagold.com
Erin O’Toole
Analyst, Investor Relations
erin.otoole@novagold.com
Contact Us
59

NOVAGOLD Marketing Presentation - May 2015

  • 1.
    novagold.com NYSE-MKT, TSX: NG| May 2015 The Institutional-Quality Gold Development Company
  • 2.
    Cautionary Statements REGARDING FORWARD-LOOKINGSTATEMENTS This presentation includes certain “forward-looking statements” within the meaning of applicable securities laws, including the United States Private Securities Litigation Reform Act of 1995. All statements, other than statements of historical fact, included herein including, without limitation, statements relating to Donlin Gold’s future operating or financial performance, are forward- looking statements. Forward-looking statements are frequently, but not always, identified by words such as “plans”, “expects”, “anticipates”, “believes”, “intends”, “estimates”, “potential”, “possible” and similar expressions, or statements that events, conditions or results “will”, “may”, “could”, or “should” occur or be achieved. These forward-looking statements are set forth in the slides pertaining to the implementation of the Donlin Gold second updated Feasibility Study and pertaining to the implementation of the Galore Creek Pre-Feasibility Study, the factors that may influence future gold price performance, and the potential future value of gold, and may include statements regarding perceived merit of properties; exploration results and budgets; mineral reserves and resource estimates; work programs; capital expenditures; timelines; strategic plans; completion of transactions; market price of precious or base metals; or other statements that are not statements of fact. Forward-looking statements involve various risks and uncertainties. There can be no assurance that such statements will prove to be accurate, and actual results and future events could differ materially from those anticipated in such statements. Important factors that could cause actual results to differ materially from our expectations include the uncertainties involving the need for additional financing to explore and develop properties and availability of financing in the debt and capital markets; uncertainties involved in the interpretation of drilling results and geological tests and the estimation of reserves and resources; the need for continued cooperation between NOVAGOLD and Barrick Gold in the exploration and development of the Donlin Gold property; the need for continued cooperation between NOVAGOLD and Teck Resources Ltd. in the exploration and development of the Galore Creek property; the need for cooperation of government agencies and native groups in the development and operation of properties; the need to obtain permits and governmental approvals; risks of construction and mining projects such as accidents, equipment breakdowns, bad weather, non-compliance with environmental and permit requirements, unanticipated variation in geological structures, ore grades or recovery rates; unexpected cost increases; fluctuations in metal prices and currency exchange rates; and other risks and uncertainties disclosed in reports and documents filed by NOVAGOLD with applicable securities regulatory authorities from time to time. The forward-looking statements made herein reflect our beliefs, opinions and projections on the date the statements are made. Except as required by law, we assume no obligation to update the forward-looking statements of beliefs, opinions, projections, or other factors, should they change. REGARDING SCIENTIFIC AND TECHNICAL INFORMATION Unless otherwise indicated, all reserve and resource estimates included in this presentation have been prepared in accordance with Canadian National Instrument 43-101 Standards of Disclosure for Mineral Projects (“NI 43-101”) and the Canadian Institute of Mining, Metallurgy and Petroleum Definition Standards for Mineral Resources and Mineral Reserves (“CIM Definition Standards”). Canadian standards, including NI 43-101, differ significantly from the requirements of the United States Securities and Exchange Commission (“SEC”), and reserve and resource information in this presentation may not be comparable to similar information disclosed by U.S. companies. In particular, and without limiting the generality of the foregoing, the term “resource” does not equate to the term “‘reserves”. Under U.S. standards, mineralization may not be classified as a “reserve” unless the determination has been made that the mineralization could be economically and legally produced or extracted at the time the reserve determination is made. At this time, both of Donlin Gold and Galore Creek projects are without known reserves, as defined under SEC Industry Guide 7. The SEC’s disclosure standards normally do not permit the inclusion of information concerning “measured mineral resources”, “indicated mineral resources” or “inferred mineral resources” or other descriptions of the amount of mineralization in mineral deposits that do not constitute “reserves” by U.S. standards in documents filed with the SEC. U.S. investors should also understand that “inferred mineral resources” have a great amount of uncertainty as to their existence and great uncertainty as to their economic and legal feasibility. It cannot be assumed that all or any part of an “inferred mineral resource” will ever be upgraded to a higher category. Under Canadian rules, estimated “inferred mineral resources” may not form the basis of feasibility or pre-feasibility studies except in rare cases. Investors are cautioned not to assume that all or any part of an “inferred mineral resource” exists or is economically or legally mineable. Disclosure of “contained ounces” in a resource is permitted disclosure under Canadian regulations; however, the SEC normally only permits issuers to report mineralization that does not constitute “reserves” by SEC standards as in-place tonnage and grade without reference to unit measures. The requirements of NI 43-101 for identification of “reserves” are also not the same as those of the SEC, and reserves reported in compliance with NI 43-101 may not qualify as “reserves” under SEC standards. Accordingly, information concerning mineral deposits set forth herein may not be comparable to information made public by companies that report in accordance with United States standards. All dollar amounts quoted in this report are in U.S. currency unless otherwise noted. 2
  • 3.
    Roadshow Participants Dr. ThomasKaplan Chairman ▸ Chairman and Chief Investment Officer of The Electrum Group LLC, a privately held natural resources investor that controls a diversified portfolio of precious and base metals assets Gregory Lang President & CEO ▸ Former President of Barrick Gold North America ▸ 35 years experience building & operating major mines ▸ Intimate knowledge of Donlin Gold Mélanie Hennessey VP, Corporate Communications ▸ Held variety of executive and senior IR & corporate communications positions with Goldcorp, New Gold, and Hecla Mining Company ▸ Leading NOVAGOLD’s internal and external communications functions 3
  • 4.
    Why Gold? GoldHas Been in a Secular Bull Market Since 2000 RISING TIDE We believe that gold is in a secular bull market, driven by financial and macro- economic developments, a shift in central bank activity, and significant supply/demand pressures. “Experienced observers will note that sentiment is like the seasons, those espousing 'hunker down' in the gold industry will be clamoring for growth when the next leg in the bull market unfolds” 4
  • 5.
    Why Gold? AValuable Portfolio Diversifier 5 Comparative Returns Note: T-note, and T-bond are average rates of return. Gold provides excellent portfolio diversification due to its low correlation with most other asset classes, including equities, bonds, other commodities, and the U.S. dollar. Unlike other commodities, gold tends to retain value during recessions and deflationary periods. Gold’s performance over the last decade vindicates its status as a valuable diversifier. Over the last decade, gold has surged relative to other investment classes; it has outperformed equities, risen in price as oil fell, and outperformed the Commodity Research Bureau (CRB) Futures Index by 25% between December 2009 and December 2014. We believe it will continue to do so because gold is more than a mere commodity. PORTFOLIO DIVERSIFICATION AND CAPITAL PRESERVATION Gold Has Retained Value in Uncertain Times 100.0% 40.0% 44.0% 89.0% 27.0% (5.0%) (50.0%) (65.0%) (31.0%) (80.0%) (60.0%) (40.0%) (20.0%) 0.0% 20.0% 40.0% 60.0% 80.0% 100.0% 120.0% 1814 to 1830 1864 to 1897 1929 to 1933 Gold Silver Other Commodities SOURCE: INCREMENTUM AG. “AFTER A 40-YEAR SECULAR TREND OF ATTEMPTED DE-MONETIZATION, GOLD IS RE-ASSERTING ITSELF AS THE ONLY FINANCIAL ASSET THAT DOESN’T REPRESENT SOMEONE ELSE’S LIABILITY” SOURCE: CPM GROUP. Percent Change 31-Dec-14 1 year 5 year 10 year Gold $1,184.10 -1.5% 8.0% 170.1% Silver $15.60 -19.5% -7.4% 128.2% Oil $53.27 -45.9% -33.3% 22.6% S&P 500 2,058.90 11.4% 84.6% 69.9% FTSE 6566.09 -2.7% 21.3% 36.4% Nikkei 17450.77 7.1% 65.5% 51.9% MSCI World Index 1709.67 5.0% 48.8% 46.2% $/Euro $1.21 -12.0% -15.5% -10.7% 10 Year T-Note 10.4% 29.2% 41.4% 30 Year T-Bond 27.3% 67.6% 95.8%
  • 6.
    GOLD HAS BEENTHE BEST PERFORMING CURRENCY OVER THE LAST DECADE Gold Price History In Major World Currencies 6 -50% 0% 50% 100% 150% 200% 250% 300% 350% Dec-05 Dec-06 Dec-07 Dec-08 Dec-09 Dec-10 Dec-11 Dec-12 Dec-13 Dec-14 Gold in Euros Gold in Pound Sterling Gold in Indian Rupee Gold in Swiss Franc Gold in Australian Dollar Gold in US Dollars Gold Price Percentage Increase
  • 7.
    Why Gold? GoldIs More Than a Commodity “OIL IS A COMMODITY. GOLD IS A CURRENCY.” 1 Gold has served mankind for five millennia, protecting wealth from high inflation, negative real interest rates, volatile currencies, rising and falling empires, declining stock values, and other crises. We believe that this is because gold is more than a commodity; it is a currency. HISTORIC HAVEN Gold has risen in price as oil fell sharply in Q4 2008 and again in Q2 2011 and Q4 2014, signifying a historic decoupling. The plunge in oil prices since November 2014 has pushed the gold/oil ratio to the highest level since 1999. GOLD AND OIL 1. Thomas Kaplan, quote made on May 2014. Gold & Oil: 2007 - 2015 Gold & Oil: November 2014 – January 2015 USD/oz. USD/oz.$/Barrel $/Barrel SOURCE: BLOOMBERG $20 $40 $60 $80 $100 $120 $140 $160 $300 $500 $700 $900 $1,100 $1,300 $1,500 $1,700 $1,900 $2,100 Gold Oil $40 $45 $50 $55 $60 $65 $70 $75 $80 $85 $1,000 $1,050 $1,100 $1,150 $1,200 $1,250 $1,300 $1,350 Gold Oil 7
  • 8.
    Why Gold? SafeHaven that has Retained Its Value 8 HISTORICAL DEFLATIONARY PRECEDENT Gold has historically retained value on a relative and absolute basis. When imploding asset classes created a deflationary spiral in 2008 and 2009, oil, equities, currencies, agricultural and commodities declined. As a safe haven, gold retained its value, as investors sought to protect their savings and hedge against financial market default. In prior periods of significant economic downturn such as the Great Depression, average gold prices rose. Gold Prices vs. Change in CPI, September 2008 to March 2009 Monthly Data SOURCE: CPM GROUP. Past performance is not indicative of future results. (2.0%) (1.5%) (1.0%) (0.5%) 0.0% 0.5% 1.0% $0 $200 $400 $600 $800 $1,000 Sep-08 Oct-08 Nov-08 Dec-08 Jan-09 Feb-09 Mar-09 MoM CPI Gold Price “GOLD CAN FLOURISH IN INFLATION AND IT CAN FLOURISH IN DEFLATION.” Change in CPIGold price $/oz.
  • 9.
    Why Gold? It’sScarce 9 • Gold production growth rates have slowed • New discoveries are increasingly difficult and costly to find, highly risky, and require long lead times to reach production • Central banks, formerly a source of supply, have been net purchasers since 2009. SUPPLY CHALLENGES CURRENCY DEBASEMENT Major reserve currencies are being debased. After a 40-year secular trend of attempted de-monetization, gold has re-asserted itself as the only currency that cannot be debased or printed. Past performance is not indicative of future results 1. Thomas Kaplan, quotes made on May 2012. “GOLD IS A CURRENCY THAT SIMPLY CANNOT BE DEBASED...” 1 “GOLD CANNOT BE PRINTED... AS WE KNOW, ITS DIFFICULT ENOUGH TO FIND AND MINE IT”1 Gold Vs. Yen June 2013 – January 2015 Gold Vs. Yen September 2014 – January 2015 SOURCE: BLOOMBERG SOURCE: SNL METALS & MINING 115000 120000 125000 130000 135000 140000 145000 150000 155000 6/3/2013 9/3/2013 12/3/2013 3/3/2014 6/3/2014 9/3/2014 12/3/2014 125000 130000 135000 140000 145000 150000 155000 9/1/14 10/1/14 11/1/14 12/1/14 1/1/15
  • 10.
    Why Gold? HistoricallyGold and the USD are Known to Have Concurrently Outperformed 10 Chart source: CPM Group. Note: US dollar index data from 2014 to Jan 26, 2015. 1. Thomas Kaplan, quotes made on March 2013 and May 2012 respectively. 2. December 31, 2014 to January 27, 2015. “ALL PAPER CURRENCIES ARE TOILET TISSUE; THE DOLLAR ON OCCASION IS DOUBLE-PLY”1 “TO BE BULLISH ON GOLD, ONE DOES NOT NEED TO BE BEARISH ON THE DOLLAR.”1 • While a weaker dollar encourages investors to store value in gold, a strengthening dollar can also be beneficial for the precious metal • Year-to-date, the gold price is up 9.1%, while the US dollar index is up 4.2%2 BULLISH ON GOLD AND THE DOLLAR
  • 11.
    Why Gold? Itis Honest Money THE ECB’S BALANCE SHEET HAS CORRELATED REMARKABLY WELL WITH USD GOLD PRICES SINCE THE EURO’S INCEPTION; IF THAT RELATIONSHIP HOLDS, €1.1T ECB QE COULD EQUATE TO $2,000 GOLD BY SEP-16E. 100 600 1100 1600 2100 2600 3100 Jan-10 Jul-10 Jan-11 Jul-11 Jan-12 Jul-12 Jan-13 Jul-13 Jan-14 Jul-14 Gold ECB Balance Sheet 800 850 900 950 1000 1050 1100 1150 1200 Jun-13 Sep-13 Dec-13 Mar-14 Jun-14 Sep-14 Dec-14 Gold vs. Euro “NO EX-ANTE QUANTITATIVE LIMITS ARE SET ON THE SIZE OF OUTRIGHT MONETARY TRANSACTIONS…” “THE CENTRAL BANK WILL DO “WHATEVER IT TAKES” TO SAVE THE EURO” PRESIDENT OF THE EUROPEAN CENTRAL BANK, MARIO DRAGHI REPEAT AFTER ME: “WE WILL DEFEND THE 1.20 FLOOR WITH THE UTMOST DETERMINATION… WE WILL DEFEND THE 1.20 FLOOR WITH THE UTMOST DETERMINATION…” SNB PRESIDENT THOMAS JORDAN 2012 "LET ME IMMEDIATELY STATE HERE: THE SNB REMAINS COMMITTED TO PURCHASING UNLIMITED QUANTITIES OF FOREIGN CURRENCY TO ENFORCE THE MINIMUM EXCHANGE RATE WITH THE UTMOST DETERMINATION.” SNB PRESIDENT THOMAS JORDAN 12/18/14 $0.95 $1.00 $1.05 $1.10 $1.15 $1.20 $1.25 $1.30 $1.35 1/1/2015 1/4/2015 1/7/2015 1/10/2015 1/13/2015 1/16/2015 1/19/2015 1/22/2015 1/25/2015 CHF USD Close 11
  • 12.
    What Makes NOVAGOLDUnique? Poised to become one of the largest gold producers in the world DONLIN GOLD GALORE CREEK Expected to be the largest and lowest cost copper mine in Canada 50/50 with Barrick 50/50 with Teck A DEVELOPMENT-STAGE COMPANY WITH TWO PROJECTS OF EXCEPTIONAL SCALE, QUALITY, AND JURISDICTIONAL SAFETY 12
  • 13.
    Notes: 1) Shown on100% project basis, of which NOVAGOLD holds a 50% interest 2) Measured and indicated resources inclusive of proven and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. RESERVES1 34Moz Proven & Probable Grade: 2.09 g/t RESOURCES1,2 39Moz Measured & Indicated Grade: 2.24 g/t 6Moz Inferred Grade: 2.02 g/t (inclusive of P&P reserves) AMONG THE WORLD’S MOST SIGNIFICANT AND HIGHEST-GRADE GOLD DEPOSITS 13 Donlin Gold: A Large High-Grade Gold Project
  • 14.
    ARGUABLY THE MOSTIMPORTANT GOLD PROJECT IN THE WORLD TODAY partnerships grade growthjurisdiction size DONLIN GOLD longevity leverage to gold 14 Donlin Gold: The Right Project
  • 15.
    A REMARKABLE RESOURCEAMONG EMERGING OPEN-PIT GOLD DEPOSITS Donlin Gold: The Emerging Top-Tier Producer in the Safest Jurisdiction 0.00 0.20 0.40 0.60 0.80 1.00 1.20 1.40 1.60 Donlin Gold Metates Pascua Lama Livengood Blackwater Courageous Lake Mt. Todd Merian Morelos Stibnite Rainy River Cerro Maricunga Dublin Gulch Haile 1.102 0.66 0.64 0.58 0.41 0.39 0.37 0.35 0.34 0.34 0.23 0.23 0.21 0.13 1.501 ProjectedAnnualGoldProduction (millionsofounces) Notes: • Peer group data as per latest company documents, public filings and websites. Comparison group based on large (M&I+P&P 4Moz cut off), North/South American and Oceanian gold-focused development projects where the majority of the M&I resource is open-pit. • Donlin Gold data as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. Represents 100% of measured and indicated resources of which NOVAGOLD’s share represents 50%. Measured and indicated resources inclusive of proven and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. (1) Projected annual gold production during first five full years of mine life; (2) Projected annual gold production during full life of mine. 0.0 5.0 10.0 15.0 20.0 25.0 30.0 35.0 40.0 Donlin Gold Pascua Lama Metates Livengood Blackwater Courageous Lake Mt. Todd Rainy River Stibnite Merian Cerro Maricunga Morelos Dublin Gulch Haile 39.0 21.8 19.0 15.7 9.2 8.0 7.8 6.4 5.5 5.5 5.2 5.0 4.9 4.0 M&IGoldResource (millionsofounces) ▶ Donlin Gold’s size and production profile clearly distinguish it from its peers 15
  • 16.
    Notes: Donlin Gold projectedannual production represents 100% of which NOVAGOLD’s share is 50%. All other production estimates, with the exception of Goldstrike and Pueblo Viejo, are based on published 2014 annual gold production sourced from SNL Metals & Mining. Muruntau 2014 production sourced from Mineweb, Metals Focus. Excludes Newmont’s Nevada Operations and Kloof/Diefontein Complex that consist of multiple mines. Analysis includes life of mine data for Donlin Gold. 1) Goldstrike and Pueblo Viejo represents the published 2015 gold production guidance. 2) If put into production as contemplated by the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. 151 MINES >100 Koz 19 MINES >500 Koz 2 MINES >800 Koz 5 MINES/ Projects >1 Moz GOLDSTRIKE1 USA DONLIN GOLD USA ▸ 1.5 Moz/year in first five full years2 ▸ 1.1 Moz/year LOM1 GRASBERG Indonesia 1 Only undeveloped asset in this category in North America Mines the Size of Donlin Gold are Scarce ONLY FIVE MINES/PROJECTS IN THE WORLD ARE SLATED TO PRODUCE >1MOZ/YEAR 16 PUEBLO VIEJO1 Dominican Republic MURUNTAU Uzbekistan
  • 17.
    Donlin Gold: TheRight Project HIGH-GRADE OPEN-PIT MINE partnerships grade growthjurisdiction size DONLIN GOLD longevity leverage to gold 17
  • 18.
    Notes: See “Cautionary NoteConcerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. 1) Average grade of all deposits globally over 1 Moz in size, sourced from “2013 Global Gold Mine and Deposit Rankings” – Natural Resource Holdings and Visual Capitalist. 2) Donlin Gold data as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. Represents 100% of measured and indicated resources of which NOVAGOLD’s share is 50%. Measured and indicated resources are inclusive of proven and probable reserves. World Avg. Grade1: 1.01 g/t Donlin Gold Avg. Grade2: 2.24 g/t Reserve grades continue to decline while sources for emerging production to replace mined-out capacity have become increasingly scarce DONLIN GOLD’S HIGH GRADE ENDOWMENT PROVIDES RESILIENCE TO GOLD PRICE CYCLES Donlin Gold: Is More than Double the Grade of the Average Gold Deposit in the World 18
  • 19.
    Donlin Gold: TheRight Project SUBSTANTIAL EXPLORATION POTENTIAL partnerships grade growthjurisdiction longevity leverage to gold size DONLIN GOLD 19
  • 20.
    MULTIPLE DRILL PROSPECTSAND TARGETS EXIST ALONG 8KM TREND Donlin Gold: Excellent Exploration Potential 20 The next big gold discovery? ▶ Potential to expand current open-pit resources along strike and at depth ▶ Good prospects to discover meaningful deposits outside current mine footprint • Reserves and resources are contained within just 3 km of an 8 km long trend ▶ Inferred mineral resource: 6 Moz of gold mainly inside the reserve pit • Upside potential to project economics ▶ In-pit area covers 1,600 acres (~2%) of the 80,000 acres comprising the entire land package
  • 21.
    Donlin Gold: Reserve& Resource Growth Notes: Donlin Gold data as per NOVAGOLD public documents. Represents 100% of measured and indicated resources of which NOVAGOLD’s share represents 50%. Measured and indicated resources are inclusive of proven and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. 2006 ~17 Moz 2011 39 Moz Expansion Potential OVER FIVE YEARS RESOURCES INCREASED 135% 21
  • 22.
    Donlin Gold: TheRight Project 27-YEAR MINE LIFE; STRONG LEVERAGE TO GOLD PRICE partnerships grade growthjurisdiction longevity leverage to gold size DONLIN GOLD 22
  • 23.
    0 5,000 10,000 15,000 20,000 25,000 30,000 1,200 1,300 1,5001,700 2,000 2,500 6.2B 8.2B 11.6B 14.6B 19.2B 27.0B NPV(US$inmillions) Gold Price (US$) NPV INCREASES ~20X WITH ~2X INCREASE IN GOLD PRICE Donlin Gold: Significant Value Upside with Higher Gold Prices 23 Notes: Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012 . All dollar figures are in USD and reflect after-tax net present value (at a 0% and 5% discount rates) of the Donlin Gold project as of 1/1/2014. At a 5% discount rate, the net present value is: $547 m @ $1,200 gold; $1,465m @ $1,300 gold; $3,147m @ $1,500 gold; $4,581 m @ $1,700 gold; $6,722 m @ $2,000 gold; and $10,243 m @ $2,500 gold. Project development costs prior to 1/1/2014 are treated as sunk costs. 27year mine life NPV at 0%NPV at 5% ▶ Project has a positive return that increases substantially with higher gold prices ▶ Good payback at a broad range of gold prices ▶ Significant exploration upside on the mineralized trend ▶ Long mine life offers high likelihood of enjoying one or more cyclical bull markets over the period of the mine’s operation
  • 24.
    Donlin Gold: ConsistentlyAdvancing the Project 0 10 20 30 40 50 60 2008 2009 2010 2011 2012 2013 2014 2015F 53 21 42 45 37 24 28 25 CO-OWNERS COMMITTED TO MOVING DONLIN GOLD THROUGH PERMITTING TO A CONSTRUCTION DECISION AT A MEASURED PACE 24 ProjectFundingon100%basis(US$Millions) Notes: The data presented above is as per NOVAGOLD’s public disclosures. The Donlin Gold LLC, formed in December 2007, is owned 50/50 by Barrick Gold Corporation and NOVAGOLD. NOVAGOLD contributed 50% of project funding shown above. Filed Donlin Gold FS adding 14.7Moz Optimization studies completed, reserves up by 4.3Moz Updated FS, resources increased 135% from 2006 FS approved, permitting commenced Initial draft EIS completed Anticipate publishing draft EIS Expansion-drilling campaign identified additional resource potential Public scoping completed
  • 25.
    Notes: Data sourced fromSNL Metals & Mining. 1) Based on announced mining startup dates. Expansions and mine redevelopments are not included as they are not comparable with new mine developments. 27 mines ~8 years discovery to production 57 mines 111 mines ~11 years discovery to production ~18 years discovery to production 0 5 10 15 20 25 30 35 1985 1986 1987 1988 1989 1990 1991 1992 1993 1994 1995 1996 1997 1998 1999 2000 2001 2002 2003 2004 2005 2006 2007 2008 2009 2010 2011 2012 2013 AverageNumberofYearsfromDiscoverytoProduction Startup Year ▸ Donlin Gold is more than halfway through permitting & will be ready for a construction decision when sentiment returns DEVELOPMENT TIMELINE OF NEW GOLD PROJECTS HAS MORE THAN DOUBLED Keeping to our Timetable: Project Progressing as Forecasted 25
  • 26.
    0 2 4 6 8 10 12 14 16 0 1,000 2,000 3,000 4,000 5,000 6,000 7,000 8,000 9,000 10,000 1997 1999 20012003 2005 2007 2009 2011 2013 Notes: Data as per SNL MEG’s MineSearch database, Company reports, SNL MEG estimates. Thomson Reuters. A gold discovery of 5 Moz or more is considered substantial. Number of discoveries data not yet available for 2014. NumberofGoldDiscoveries Gold Discovered Exploration Budget (US$M) 2012 highest year on record for exploration spending and first year in over two decades with no discoveries DESPITE RECORD HIGH EXPLORATION SPENDING LEVELS THE GOLD INDUSTRY HAS EXPERIENCED A RECENT DROP IN DISCOVERIES Why Donlin Gold? No New Substantial Discoveries 26
  • 27.
    LOCATED IN ALASKA,ONE OF THE TRULY SAFE MINING JURISDICTIONS Donlin Gold: The Right Project partnerships grade growthjurisdiction size DONLIN GOLD longevity leverage to gold 27
  • 28.
    JURISDICTIONAL APPEAL ISCOMPRISED OF FIVE CORNERSTONES: 1) MINERAL POTENTIAL 2) ESTABLISHED MINING PRACTICE 3) POLITICAL AND SOCIAL STABILITY 4) EXCELLENT LOCAL PARTNERSHIPS AND, OF “EXISTENTIAL IMPORTANCE”... 5) A FULL EMBRACE OF THE RULE OF LAW Donlin Gold: Leverage in a Place WhereYou Can Keep the Rewards – Location, Location, Location 28 Political Risk Insignificant Low Medium High Extreme Source: SNL Metals & Mining, Political Risk Assessment, March 16, 2015
  • 29.
    Donlin Gold locatedin Alaska, one of the safest jurisdictions in the world with a history of successful mine development ▶ Alaska is the second largest U.S. gold-producing State ▶ Well-defined permitting process ▶ Natural resource projects integral to the State’s economy ▶ Strong and time-tested community support ALASKA – A RESOURCE-RICH STATE WITH AN ESTABLISHED RULE OF LAW Donlin Gold: Located in a Favorable Jurisdiction 2929
  • 30.
    STRONG PARTNERSHIPS Donlin Gold:The Right Project partnerships grade growthjurisdiction size DONLIN GOLD longevity leverage to gold 30
  • 31.
    Barrick Gold FourthQuarter 2014 Results – Full Donlin Gold Disclosure “The 50% owned Donlin Gold project located in Alaska is one of the largest undeveloped gold deposits in the world. In terms of size, grade, and jurisdictional safety, Donlin Gold is an excellent asset in Barrick's portfolio with significant leverage to the price of gold. The Donlin Gold project has approximately 39 million ounces of contained gold (100% basis) in the measured and indicated resource categories (approximately 8 million tonnes grading 2.52 g/t (measured) and 533 million tonnes grading 2.24 g/t (indicated)). In addition to its already large mineral endowment, the project also has exploration potential which could expand the current open pit resource. Under our disciplined capital allocation framework, we have continued to work with our partner, Novagold Resources, to advance the Donlin Gold project. Current activities, by which we maintain and enhance the option value of this project at a modest cost, are focused on permitting, community outreach and workforce development. In 2014, Donlin Gold secured long-term surface use rights and significantly advanced the permitting of the Donlin Gold project which is now about halfway complete. Barrick is working closely with its partner on alternatives designed to minimize initial capital outlay. The outcome of that effort may include engagement of third party operators and exploring possibilities for third party financing of some capital intensive infrastructure. Collectively, we are also investing about $3 million (100% basis) on technical studies to identify potential design and execution enhancements. Donlin Gold has substantial leverage to gold prices and has the potential to add significant value to Barrick and its future growth pipeline in a higher gold price environment. Any decision to proceed with development, either as currently envisaged, or in an optimized scenario, will depend on the project meeting Barrick's minimum hurdle rate which will depend in large part on the prevailing gold prices and market conditions.” Donlin Gold: Perfect Alignment between Partners 31 Notes: As per Barrick Gold’s Fourth Quarter and Full Year 2014 Results disclosed on February 18, 2015.
  • 32.
    COLLABORATING WITH OURPARTNER TO MAXIMIZE PROJECT RETURN Donlin Gold: Partnerships & Activities Barrick and NOVAGOLD are jointly committed to working together to create shareholder value from Donlin Gold’s unique optionality ▶ Project activities continue to progress as planned ▶ After further de-risking, we are encouraged by Donlin Gold’s prospects ▶ Focused on advancing Donlin Gold through permitting to a record of decision ▶ Working together with Barrick to evaluate development scenarios ▶ Neither partner has a build at any gold price mentality “Both companies are happy to take a sober and constructive view. We don't want to subsidize the world's consumption of gold by squandering the treasures that Mother Nature has given us and we're happy to wait for the higher gold prices that will make the project's economics sing.” – Thomas S. Kaplan, Chairman of NOVAGOLD RETAINING THE GREATEST VALUE WHILE ENSURING CAPITAL EFFICIENCY 32
  • 33.
    Donlin Gold: Miningwith the Local Communities ALASKA NATIVE CORPORATIONS: LEADERS OF REGIONAL ECONOMIC DEVELOPMENT 33 ▶ ANCSA established 40 years ago; resolved legal issues related to Native land claims ▶ Lands valuable for resource potential selected by Regional Corporations under ANCSA ▶ Native corporations have an owner’s interest in the development of the selected lands to support the economic prosperity of their shareholders ▶ Mining is compatible and consistent with subsistence lifestyles ▶ Donlin Gold is located on private land specifically selected for its resource development potential 33
  • 34.
    Donlin Gold hasthe support of the land owners through a 20+ year relationship “Calista and TKC are not only stakeholders, but are the legislatively mandated landowners charged with the responsibility of seeing the project to fruition in an environmentally responsible manner.” – June MacAtee, Vice President of Calista Corporation (mineral owner) "Since 1995, Donlin Gold has worked constructively in our region and I know our partnership will benefit our shareholders for many generations. Today's agreement sets the basis for a long and productive relationship that with construction of the mine will provide jobs and financial value to the shareholders in our 10 villages.” – Maver Carey, President & CEO of The Kuskokwim Corporation (surface owner) STRONG AND TIME-HONORED RELATIONSHIPS WITH STAKEHOLDERS Donlin Gold: Durable, Long-Term Agreements with the Native Corporations 3434
  • 35.
    “We, the Boardmembers of NOVAGOLD, are truly proud of the fact that our company and NFWF have come together to create an extraordinary partnership that can serve as a model for the sustainable development of natural resources.” Thomas Kaplan, Chairman “The lands and waters of Alaska provide a home for an incredible number of fish and wildlife species. We applaud this commitment from NOVAGOLD and Donlin Gold as a significant contribution toward conserving the wetlands, streams and wild places of Alaska for future generations.” Jeff Trandahl, Executive Director & CEO The partnership supports regional solutions driven by locals to: ▶ Promote healthy watersheds ▶ Enhance and protect wildlife habitat ▶ Advance sustainable fisheries PROTECT, RESTORE AND CONSERVE ALASKA FISH AND WILDLIFE Donlin Gold: A Unique Partnership with the National Fish and Wildlife Foundation (NFWF) 35
  • 36.
    DEVELOPMENT TIMELINE -ADVANCING TOWARD A CONSTRUCTION DECISION Donlin Gold: The Project Permitting is On Track 16 years ̴ 4 27+ years EXPLORATION& ENVIRONMENTAL STUDIES PERMITTING ENGINEERING& CONSTRUCTION OPERATION WE ARE HERE HALF WAY THROUGH PERMITTING 1.5 Moz/year first five full years1 1.1 Moz/year life of mine1 ̴ 5 Notes: 1) Donlin Gold data as per the second updated feasibility study. Projected average annual production represents 100% of which NOVAGOLD’s share represents 50%. 2) Alaska Dispatch News, “Prospect of Donlin gold mine brings support, despite potential effect on Iditarod Trail”, October 16, 2014 Federal and State agencies are working cooperatively, with day-to-day support from Donlin Gold, to efficiently move the project through the EIS and permitting processes. Major permit applications are well underway • Air quality • Water discharge and usage • Pipeline plan of development • Wetlands • Dam safety 36 “A hearing on a proposal to build a 350-mile natural gas pipeline across the Alaska wilderness from Cook Inlet to the proposed Donlin Gold project along the Kuskokwim River in the Interior turned into something of a love fest for the mining company...”2
  • 37.
    Notice of Intent toPrepare EIS Draft EIS Final EIS Record of Decision Initial permit applications Submitted: 08/12 Notice of intent Issued: 12/14/12 Public scoping period Ended: 03/29/13 Scoping summary document Completed: 08/13 Development of alternatives Completed: Q2/14 Initial drafts of EIS chapters Completed: Q4/14 Agency & Donlin Gold review Completed: Q4/14 Prepare draft EIS Publish draft EIS Public comment period Prepare draft final EIS Agency review Publish final EIS Record of decision 2012-2013 2013-2016 2016-2017 PAST THE HALFWAY MARK IN THE EIS PROCESS Donlin Gold: Permitting Milestones 37
  • 38.
    COLLABORATING WITH OURPARTNER TO MAXIMIZE PROJECT RETURN Donlin Gold: Optimization Studies 38 ▶ Optimization studies underway to evaluate opportunities to reduce initial owner capital • Third-party financing or owner/operator prospects (≈$1.0B potential reductions i.e. gas pipeline, port facilities, oxygen plant, mining fleet) • Conducting technical studies ($3.0M) with experts from both companies and independent consultants to identify potential design and execution enhancements from FSU2 Potential benefits: ▶ Lower initial owner capital required to build ▶ Opportunity to implement lessons learned from past/current experience in building and operating assets such as Pueblo Viejo ▶ Opportunity to expand with future cash-flow generation ▶ When sentiment returns in the gold sector, the market will seek out projects with leverage and growth
  • 39.
    THE KIND OFASSET YOU CAN BUILD A COMPANY AROUND Galore Creek: A Significant Copper-Gold-Silver Asset in Canada Notes: 1) Represents 100% of measured and indicated resources of which NOVAGOLD’s share is 50%. Measured and indicated resources inclusive of proven and probable reserves. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. 9Blbs Grade: 0.50% 8Moz Grade: 0.31 g/t 136 Moz Grade: 5.21 g/t copper gold silver M&I Resources1 39
  • 40.
    0.00 0.05 0.10 0.15 0.20 0.25 0.30 0.35 0.40 0.45 0.50 Galore Creek Pebble Copper Mountain Red ChrisBerg Schaft Creek New Prosperity KSM Mount Milligan Casino 0.50 0.40 0.33 0.33 0.30 0.26 0.24 0.21 0.19 0.19 AMONG HIGHEST COPPER GRADE COMPARED TO NORTH AMERICAN ASSETS Galore Creek: Peer ComparisonP&P+M&Igrade(Cu%) Notes: Peer group data as per latest company documents, public filings and websites. 40
  • 41.
    May 1, 2015millions Cash and term deposits1 $136 2015 Budget2 Donlin Gold $13 Galore Creek $2 G&A, interest & Donlin Gold joint studies $14 Repayment of outstanding convertible notes3 $16 Anticipated year-end cash position $120 1) After repayment of convertible notes, includes US$85 million in term deposits. 2) 2015 anticipated budget expenditure disclosed on January 28, 2015. 3) The convertible notes were repaid on May 1, 2015. SUFFICIENT CASH ON HAND TO PROGRESS DONLIN GOLD THROUGH PERMITTING AND MEET FINANCIAL OBLIGATIONS Clear Focus and Strong Funding to Execute on all Fronts 41
  • 42.
    CONTINUE TO EXECUTEAND DELIVER ON OUR BUSINESS PLAN 2015 Outlook 1 2 3 4 5 PRIORITY PRIORITY PRIORITY PRIORITY PRIORITY Advance Donlin Gold permitting to a construction decision Advance Galore Creek mine planning and project design Evaluate opportunities to monetize the value of Galore Creek Safeguard our cash position Maintain strong relationships with all stakeholders COMMITTED TO GOLD THROUGH VARIOUS MARKET CYCLES 42
  • 43.
    26.7% 11.3% 6.9% 5.2%3.0% 47% A BLUE CHIPINSTITUTIONAL QUALITY INVESTMENT Why Invest in NOVAGOLD? Held by top 5 shareholders1 53% Electrum Strategic Resources LP Paulson & Co. Inc The Baupost Group, L.L.C. Van Eck Associates Corporation Tocqueville Asset Management Other Market Cap3 $1.3B Cash and Term Deposits2 $136M 1) Shareholder positions are based on the latest 13-F filings 2) Includes $85 million in term deposits as of May 1, 2015. 3) Market Capitalization as of May 20, 2015 based on 317.8 million shares issued and outstanding and NG share price of $4.12. NYSE-MKT, TSX: NG 43
  • 44.
    NOVAGOLD focused on executionand delivery of our business plan NOVAGOLD Highlights Safe Geo-Political Environment: Alaska and British Columbia, top-rated mining jurisdictions Accomplished Team: 185 years cumulative experience Prolific Production Profile: Donlin Gold expected to be one of industry’s top producing assets; strong leverage to gold Supportive Stakeholders: Long standing shareholders and engaged partners Strong Balance Sheet: $136m cash + term deposits as of May 1, 2015 Top Tier Assets: Donlin Gold: Large, high- grade deposit past 50% mark in permitting; great additional exploration potential 44
  • 45.
  • 46.
    ADVANCING DONLIN GOLDUP THE VALUE CHAIN Donlin Gold: A Project Overview 46 ▶ Donlin Gold LLC is the operating company ▶ 50/50 ownership by NOVAGOLD and Barrick Gold ▶ Board of Directors has two representatives from each company • Chairman rotates every year • Each company has the right to appoint the Donlin Gold General Manager every two years ▶ Operates under agreements with Alaska Native Claims Settlement Act (ANCSA) landowners • Calista Corporation (Subsurface minerals and surface lease) • The Kuskokwim Corporation (Surface use agreement) ▶ Project office in Anchorage • 22 full-time employees and 4 contractors ▶ Strong track record for local hiring
  • 47.
    DONLIN GOLD SLATEDTO BE A STATE-OF-THE-ART SIGNIFICANT MINE Donlin Gold: Project Highlights Reserves: 33.9 Moz Au (505M tonnes ore)1 Resources: 5.1 Moz M&I (excluding P&P) and 6.0 Moz Inferred1 Mine Life: ~27 years Production: Year 1-5,1.5 Moz/year; LOM,1.1 Moz/year Operation: Open-pit, conventional truck & shovel Milling: 53.5k tonnes/day, sulfide flotation, pressure oxidation (POX), carbon-in-leach recovery (CIL) Strip ratio: 5.5 = 2.8B tonnes waste rock Tailings: Fully lined storage facility Power: 153MW average site-generated load, fueled by natural gas transported via a 315-mile pipeline Logistics: All consumables supplied by Kuskokwim River transportation system with port near Jungjuk Creek See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve and Resource Base” table with footnotes. 47
  • 48.
    Donlin Gold: Expectedto Provide Three Decades of Low Cost Production LOW OPERATING CASH COSTS AND ALL-IN SUSTAINING COSTS Open-pit mining2 270 Processing 257 G&A, royalties, land & other3 108 Total $635 Open-pit mining2 133 Processing 208 G&A, royalties, land & other3 70 Total $411 Cash Costs1 Per Ounce First Five Years Notes: Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. US GAAP cost of sales, excluding depreciation and reclamation 1) Net of deferred costs 2) Based on $1,200/oz gold price All-in Sustaining Costs Per Ounce Cash costs1 635 Sustaining capex 50 Corporate administration 28 Reclamation 22 Total $735 Cash costs1 411 Sustaining capex 83 Corporate administration 21 Reclamation 17 Total $532 Life of Mine Cash Costs1 Per Ounce All-in Sustaining Costs Per Ounce 48
  • 49.
    WELL POSITIONED TOSHARE UPFRONT COSTS WITH THIRD PARTIES Donlin Gold: Capital Expenditures Areas US$M1 Opportunities1 Mining 345 Leasing equipment ~$170M of $345M Site preparation/roads 236 Process facilities 1,326 Oxygen plant could be built by third party ~$130M of $1.3B Tailings 120 Utilities 1,302 Ancillary buildings 304 Off-site facilities 243 Total Direct Costs 3,876 Owners’ cost 414 Indirect Costs 1,405 Contingency 984 Healthy Contingency Total Owner’s & Indirect Costs, and Contingency 2,803 Total Project Cost 6,679 >$1B potential initial capital reductions Gas pipeline could be built by third party $834M of $1.3B 1) Represents 100% of project’s capital expenditures 49
  • 50.
    ROBUST ECONOMICS HIGHLYLEVERAGED TO GOLD PRICES Donlin Gold: Key Performance Indicators Gold Price Unit $1,200/oz Base Case $1,500/oz $1,700/oz $2,000/oz $2,500/oz Average annual after-tax cash flow (first full five years) $M 950 1,306 1,500 1,785 2,185 Average annual after-tax cash flow (LOM) $M 500 704 815 990 1,275 NPV (5%) after-tax1 $M 550 3,147 4,580 6,720 10,240 NPV (0%) after-tax1 $M 6,200 11,631 14,620 19,250 26,975 IRR after-tax1 % 6.0 10.2 12.3 15.1 19.1 Payback period Years 9.2 6.1 5.3 4.4 3.5 Notes: Donlin Gold estimates as per the second updated feasibility study effective November 18, 2011, as amended January 20, 2012. All dollar figures are in USD and reflect after-tax net present value (at a 0% and 5% discount rates) of the Donlin Gold Project as of 1/1/2014 per the feasibility study timeline. Project development costs prior to that date are treated as sunk costs. All amounts in US dollars 1) NPVs and IRRs as at January 1, 2014. Project development costs prior to that date are treated as sunk costs. 50
  • 51.
    LARGE PROJECTS HAVEBEEN SUCCESSFULLY PERMITTED Donlin Gold: Permitting in the U.S. Project Name Location Metal Time Description Red Dog Alaska Lead/zinc ~2 years • Expansion • EIS completed in 2009 • Development started on schedule in 2010 Fort Knox Alaska Gold ~3 years • Expansion – new heap leach facility • Permitting completed in 2007 Pogo Alaska Gold ~3 years • New mine • Permitting completed in 2004 • Operations began in 2006 Arturo Nevada Gold ~4 years • Major pit expansion • New waste rock and heap leach facilities • EIS/ROD completed in May 2014 Rochester Nevada Silver ~1 year • Expansion – new heap leach & mine reopening • EA/permitting completed in 2011 Cortez Nevada Gold ~3 years • Major pit expansion • EIS/permitting completed in 2008/2009 Goldstrike Nevada Gold ~2 years • Major pit expansion • Waste rock and tailings facilities • ROD approving the project was in 2009 Hycroft Nevada Gold ~2 years • Reactivation • EIS/permitting completed in 2012 Haile South Carolina Gold ~4 years • New mine on historic property • Open pits, processing and tailings facilities • Final EIS issued July 2014, ROD issued October 2014 Pan Nevada Gold ~2 years • New open pit and heap leach • EIS/permitting completed in 2013 Long Canyon Nevada Gold ~3 years (anticipated) • New pit, heap leach, mill and tailings facility • Final EIS approved by BLM, under 30-day review 51
  • 52.
    GALORE CREEK, ANEXCEPTIONAL ASSET Galore Creek: Project Overview 52 ▶ Galore Creek Mining Corporation (GCMC) is the operating company ▶ 50/50 ownership by NOVAGOLD and Teck Resources Inc. ▶ Management Committee has two representatives from each company • Chairman rotates every year ▶ Project is located within the Tahltan Nation Territory and operates under a Participation Agreement ▶ All mineral claims are on Crown land ▶ Project office in Vancouver • Abundance of technical strength to draw from within Teck ▶ Strong track record for Tahltan hiring at project site as well as contracting and procurement with Tahltan businesses and joint ventures
  • 53.
    GALORE CREEK TOBE ONE OF CANADA’S LARGEST COPPER MINES Galore Creek: Project Highlights Reserves: 6.8 Blb Cu; 5.5 Moz Au; 102 Moz Ag1 Resources: 8.9 Blb Cu; 8.0 Moz Au; 136 Moz Ag (inclusive of reserves)1 Mine Life: ~18 years Production: Year 1-5, 400 Mlb/year Cu; LOM, 340 Mlb/year Cu Cash costs: LOM, $0.80/lb Cu at base case assumptions2 Operation: Open-pit, conventional truck & shovel Milling: +80k tonnes/day, conventional crush, grind, and Cu/Au/Ag flotation concentration, plant located in West More Valley Strip ratio: 2.2 = 1.1B tonnes waste rock Tailings: storage facility located in West More Valley next to plant Power: BC Hydro’s Northwest Transmission Line is now in service connecting from near Terrace, BC to Bob Quinn to promote remote industrial development, Galore Creek to tie into the NTL Logistics: Port facilities to be built near Stewart, BC Notes: 1) See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve and Resource Base” table with footnotes. 2) Base Price Case metal prices are US$2.65/lb Cu, US$1,100/oz Au and US$18.50 Ag and foreign exchange rate of 1.11 CAD/USD. 53
  • 54.
    ROBUST ECONOMICS HIGHLYLEVERAGED TO METAL PRICES Galore Creek: Key Performance Indicators Unit Metal Prices Copper Gold Silver US$/lb US$/oz US$/oz 2.00 900 15.00 2.65 1,100 18.50 3.00 1,100 20.00 3.50 1,200 25.00 4.00 1,300 30.00 LOM after-tax cash flow $M 1,514 5,118 6,641 9,223 11,812 NPV (5%) after-tax1 $M (969) 988 1,794 3,134 4,458 NPV (7%) after-tax1 $M (1,431) 137 778 1,837 2,877 IRR after-tax1 % 2.4 7.4 9.2 11.9 14.3 Payback period Years 13.2 7.8 6.1 4.1 3.3 Notes: Galore Creek estimates as per the 2011 Pre-Feasibility Study. All dollar figures are in CAD. See “Cautionary Note Concerning Reserve & Resource Estimates” and “Reserve & Resource Base” with footnotes in the appendix. 1) NPVs and IRRs as of two years prior to significant project spend. Project development costs prior to that point are treated as sunk costs. All amounts in CAD dollars 54
  • 55.
    NOVAGOLD: The ManagementTeam Gregory Lang President & CEO ▸ Former President of Barrick Gold North America ▸ 35 years experience building & operating major mines ▸ Intimate knowledge of Donlin Gold David Deisley Executive Vice President and General Counsel ▸ Former EVP and General Counsel of Goldcorp ▸ Regional General Counsel for Barrick Gold North America ▸ Extensive track record in project permitting, corporate social responsibility, mergers and acquisitions and corporate development ▸ 25 years of mining industry experience David Ottewell Vice President and Chief Financial Officer ▸ Former VP and Corporate Controller of Newmont Mining Corporation ▸ 25 years of mining industry experience ▸ Diverse experience in all facets of financial management, from mine operations to executive corporate financial management of premier gold producers Mélanie Hennessey Vice President, Corporate Communications ▸ Held variety of executive and senior IR & corporate communications positions with Goldcorp, New Gold, and Hecla Mining Company ▸ Leading NOVAGOLD’s internal and external communications functions Ron Rimelman Vice President, Environment, Health, Safety & Sustainability ▸ 25+ years of environmental experience, managing environmental impact assessments and permitting activities world-wide ▸ Leadership role on mine permitting and NEPA evaluations for mine projects in Alaska since 1993 Richard Williams Vice President, Engineering and Development ▸ Former Project Director for the Pueblo Viejo project in the Dominican Republic ▸ 30 years of experience developing and operating major mines world-wide ▸ Particular expertise in autoclave technology INDUSTRY LEADERS TO BRING DONLIN GOLD THROUGH PERMITTING & BEYOND 55
  • 56.
    NOVAGOLD: The Boardof Directors Dr. Thomas Kaplan Chairman Chairman and CIO of The Electrum Group LLC, a privately held natural resources investor that controls a diversified portfolio of precious and base metals assets Sharon Dowdall Former Chief Legal Officer and Corporate Secretary with Franco-Nevada, transforming an industry pioneer into one of the most successful precious metals enterprises in the world Dr. Marc Faber A well-known commentator and author on global investing, publisher of The Gloom, Boom & Doom Report Greg Lang President & CEO Former President of Barrick Gold North America, 35 years experience building & operating major mines with intimate knowledge of Donlin Gold Gil Leathley COO and Director of Sunward Resources, former Senior Vice President and Chief Operating Officer of the Company Igor Levental President of The Electrum Group LLC, former VP of Homestake Mining and International Corona Corp. Kalidas Madhavpeddi Overseas Chief Executive Officer of China Moly Corp. Former Executive with Phelps Dodge. Gerald McConnell Former Chairman and CEO of NOVAGOLD, CEO of Namibia Rare Earths Inc. Clynton Nauman CEO of Alexco Resources, formerly with Viceroy Gold and Kennecott Minerals Rick Van Nieuwenhuyse CEO of NovaCopper, founder and former CEO of NOVAGOLD Anthony Walsh Former President and Chief Executive Officer of Miramar Mining Corporation, which in 2007 was sold to Newmont Mining Corporation. 56
  • 57.
    NOVAGOLD: Reserve/Resource Table 57 DonlinGold (100% basis)* Tonnage Grade Metal content GOLD Kt g/t Au Koz Au Reserves1 Proven 7,683 2.32 573 Probable 497,128 2.08 33,276 P&P 504,811 2.09 33,849 Resources3, inclusive of Reserves Measured 7,731 2.52 626 Indicated 533,607 2.24 38,380 M&I 541,337 2.24 39,007 Inferred 92,216 2.02 5,993 Galore Creek (100% basis)* Tonnage Grade Metal content COPPER Mt % Cu Blb Cu Reserves2 Proven 69.0 0.606 0.9 Probable 459.1 0.582 5.9 P&P 528.0 0.585 6.8 Resources4, exclusive of Reserves Measured 39.5 0.25 0.22 Indicated 247.2 0.34 1.85 M&I 286.7 0.33 2.07 Inferred 346.6 0.42 3.23 GOLD Mt g/t Au Moz Au Reserves2 Proven 69.0 0.520 1.15 Probable 459.1 0.291 4.30 P&P 528.0 0.321 5.45 Resources4, exclusive of Reserves Measured 39.5 0.39 0.50 Indicated 247.2 0.26 2.04 M&I 286.7 0.27 2.53 Inferred 346.6 0.24 2.70 SILVER Mt g/t Ag Moz Ag Reserves2 Proven 69.0 4.94 11.0 Probable 459.1 6.18 91.2 P&P 528.0 6.02 102.1 Resources4, exclusive of Reserves Measured 39.5 2.58 3.27 Indicated 247.2 3.81 30.26 M&I 286.7 3.64 33.54 Inferred 346.6 4.28 47.73 * Mineral reserves are reported on a 100% basis. NOVAGOLD and Barrick each own 50% of the Donlin Gold project. NOVAGOLD and Teck each own 50% of the Galore Creek project. t = metric tonne oz = ounce lb = pound K = thousand M = million B = billion g/t = grams/tonne Approximate cut-off grades (see Resource Footnotes): Donlin Gold Reserves1: 0.57 g/t gold Resources3: 0.46 g/t gold Galore Creek Reserves2: C$10.08 NSR Resources4: C$10.08 NSR
  • 58.
    Notes: a. These resourceestimates have been prepared in accordance with NI43-101 and the CIM Definition Standard, unless otherwise noted. b. See numbered footnotes below on resource information. c. Rounding as required by reporting guidelines may result in apparent summation differences between tonnes, grade and contained metal content d. Tonnage and grade measurements are in metric units. Contained gold and silver ounces are reported as troy ounces, contained copper pounds as imperial pounds Resource Footnotes: 1) Mineral Reserves are contained within Measured and Indicated pit designs, and supported by a mine plan, featuring variable throughput rates, stockpiling and cut-off optimization. The pit designs and mine plan were optimized on diluted grades using the following economic and technical parameters: Metal price for gold of US$975/oz; reference mining cost of US$1.67/t incremented US$0.0031/t/m with depth from the 220 m elevation (equates to an average mining cost of US$2.14/t), variable processing cost based on the formula 2.1874 x (S%) + 10.65 for each US$/t processed; general and administrative cost of US$2.27/t processed; stockpile rehandle costs of US$0.19/t processed assuming that 45% of mill feed is rehandled; variable recoveries by rock type, ranging from 86.66% in shale to 94.17% in intrusive rocks in the Akivik domain; refining and freight charges of US$1.78/oz gold; royalty considerations of 4.5%; and variable pit slope angles, ranging from 23º to 43º. Mineral Reserves are reported using an optimized net sales return value based on the following equation: Net Sales Return = Au grade * Recovery * (US$975/oz – (1.78 + (US$975/oz – 1.78) * 0.045)) - (10.65 + 2.1874 * (S%) + 2.27 + 0.19) and reported in US$/tonne. Assuming an average recovery of 89.54% and an average S% grade of 1.07%, the marginal gold cutoff grade would be approximately 0.57 g/t, or the gold grade that would equate to a 0.001 NSR cutoff at these same values. The life of mine strip ratio is 5.48. The assumed life-of-mine throughput rate is 53.5 kt/d. 2) Mineral Reserves are contained within Measured and Indicated pit designs using metal prices for copper, gold and silver of US$2.50/lb, US$1,050/oz, and US$16.85/oz, respectively. Appropriate mining costs, processing costs, metal recoveries and inter ramp pit slope angles varying from 42º to 55º were used to generate the pit phase designs. Mineral Reserves have been calculated using a 'cashflow grade' ($NSR/SAG mill hr) cut-off which was varied from year to year to optimize NPV. The net smelter return (NSR) was calculated as follows: NSR = Recoverable Revenue – TCRC (on a per tonne basis), where: NSR = Net Smelter Return; TCRC = Transportation and Refining Costs; Recoverable Revenue = Revenue in Canadian dollars for recoverable copper, recoverable gold, and recoverable silver using metal prices of US$2.50/lb, US$1,050/oz, and US$16.85/oz for copper, gold, and silver, respectively, at an exchange rate of CDN$1.1 to US$1.0; Cu Recovery = Recovery for copper based on mineral zone and total copper grade; for Mineral Reserves this NSR calculation includes mining dilution. SAG throughputs were modeled by correlation with alteration types. Cash flow grades were calculated as the product of NSR value in $/t and throughput in t/hr. The life of mine strip ratio is 2.16. 3) Mineral Resources are contained within a conceptual Measured, Indicated and Inferred optimized pit shell using the following assumptions: gold price of US$1,200/oz; variable process cost based on 2.1874 * (sulphur grade) + 10.6485; administration cost of US$2.29/t; refining, freight & marketing (selling costs) of US$1.85/oz recovered; stockpile rehandle costs of US$0.20/t processed assuming that 45% of mill feed is rehandled; variable royalty rate, based on royalty of 4.5% * (Au price – selling cost). Mineral Resources have been estimated using a constant Net Sales Return cut-off of US$0.001/t milled. The Net Sales Return was calculated using the formula: Net Sales Return = Au grade * Recovery * (US$1200/oz – (1.85 + ((US$1200/oz – 1.85) * 0.045)) - (10.65 + 2.1874 * (S%) + 2.29 + 0.20)) and reported in US$/tonne. Mineral Resources are inclusive of Mineral Reserves. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. Inferred Resources are in addition to Measured and Indicated Resources. Inferred Resources have a great amount of uncertainty as to their existence and whether they can be mined legally or economically. It cannot be assumed that all or any part of the Inferred Resources will ever be upgraded to a higher category. See "Cautionary Note Concerning Reserve & Resource Estimates". 4) Mineral resources are contained within a conceptual Measured, Indicated and Inferred optimized pit shell using the same economic and technical parameters as used for Mineral Reserves. Tonnages are assigned based on proportion of the block below topography. The overburden/bedrock boundary has been assigned on a whole block basis. Mineral resources have been estimated using a constant NSR cut-off of C$10.08/t milled. The Net Smelter Return (NSR) was calculated as follows: NSR = Recoverable Revenue – TCRC (on a per tonne basis), where: NSR = Diluted Net Smelter Return; TCRC = Transportation and Refining Costs; Recoverable Revenue = Revenue in Canadian dollars for recoverable copper, recoverable gold, and recoverable silver using silver using the economic and technical parameters mentioned above. The mineral resource includes material within the conceptual M,I&I pit that is not scheduled for processing in the mine plan but is above cutoff. Mineral Resources are inclusive of Mineral Reserves. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. Inferred Resources are in addition to Measured and Indicated Resources. Inferred Resources have a great amount of uncertainty as to their existence and whether they can be mined legally or economically. It cannot be assumed that all or any part of the Inferred Resources will ever be upgraded to a higher category. See "Cautionary Note Concerning Reserve & Resource Estimates". Cautionary Note Concerning Reserve & Resource Estimates This summary table uses the term “resources”, “measured resources”, “indicated resources” and “inferred resources”. United States investors are advised that, while such terms are recognized and required by Canadian securities laws, the United States Securities and Exchange Commission (the “SEC”) does not recognize them. Under United States standards, mineralization may not be classified as a “reserve” unless the determination has been made that the mineralization could be economically and legally produced or extracted at the time the reserve determination is made. Mineral resources that are not mineral reserves do not have demonstrated economic viability. United States investors are cautioned not to assume that all or any part of measured or indicated resources will ever be converted into reserves. Further, inferred resources have a great amount of uncertainty as to their existence and as to whether they can be mined legally or economically. It cannot be assumed that all or any part of the inferred resources will ever be upgraded to a higher category. Therefore, United States investors are also cautioned not to assume that all or any part of the inferred resources exist, or that they can be mined legally or economically. Disclosure of “contained ounces” is permitted disclosure under Canadian regulations, however, the SEC normally only permits issuers to report “resources” as in place tonnage and grade without reference to unit measures. Accordingly, information concerning descriptions of mineralization and resources contained in this release may not be comparable to information made public by United States companies subject to the reporting and disclosure requirements of the SEC. NI 43-101 is a rule developed by the Canadian Securities Administrators, which established standards for all public disclosure an issuer makes of scientific and technical information concerning mineral projects. Unless otherwise indicated, all resource estimates contained in this circular have been prepared in accordance with NI 43-101 and the CIM Definition Standards. Technical Reports and Qualified Persons The documents referenced below provide supporting technical information for each of NOVAGOLD's projects. Project Qualified Person(s) Most Recent Disclosure & Filing Date Donlin Gold Gordon Seibel R.M. SME, AMEC “Donlin Creek Gold Project Alaska, USA, NI 43-101 Technical Report on Second Updated Feasibility Study” effective November 18, 2011, amended January 20, 2012. Kirk Hanson P.E., AMEC Galore Creek Jay Melnyk, P.Eng., AMEC “Galore Creek Copper-Gold Project NI 43-101 Technical Report on Pre-Feasibility Study, British Columbia – Canada” effective July 27, 2011. Greg Kulla, P.Geo., AMEC Heather White, B.Sc., P.Eng., who is a consultant to NOVAGOLD and a “qualified person” under NI 43-101, has approved the scientific and technical information included in this Reserve and Resource Table. NOVAGOLD: Reserve/Resource Table (con’t) 58
  • 59.
    NOVAGOLD RESOURCES INC. Suite720 – 789 West Pender Street Vancouver, BC Canada V6C 1H2 T 604 669 6227 TF 1 866 669 6227 F 604 669 6272 www.novagold.com info@novagold.com Mélanie Hennessey VP, Corporate Communications melanie.hennessey@novagold.com Erin O’Toole Analyst, Investor Relations erin.otoole@novagold.com Contact Us 59
