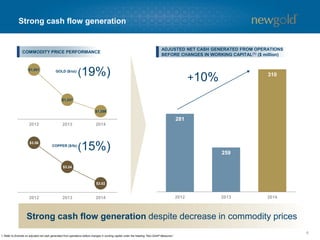

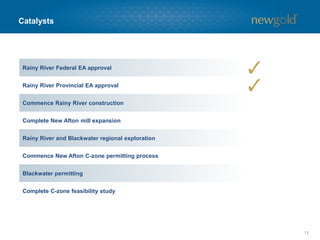

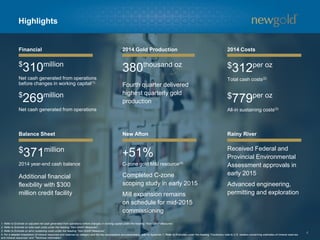

The document summarizes New Gold's fourth quarter and year-end 2014 results webcast. It highlights that in 2014 New Gold produced 380 thousand ounces of gold, generated $371 million in adjusted net cash from operations before changes in working capital, and ended the year with a $371 million cash balance. It also notes that New Gold received environmental approval for its Rainy River project in early 2015 and advanced engineering, permitting and exploration at the project. New Gold also completed a study on the potential C-zone extension at Rainy River. The document provides cautionary statements regarding the use of forward-looking information in the presentation.
