S4125_SAP portfolio and project management functional document.pdf
SAP Portfolio and project management
Software
◦
Read more
0
Save
Share
Embed
Embed presentation

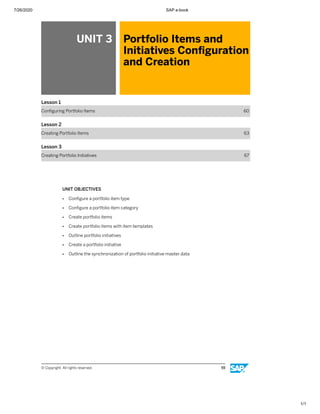

Download
Downloaded 11 times

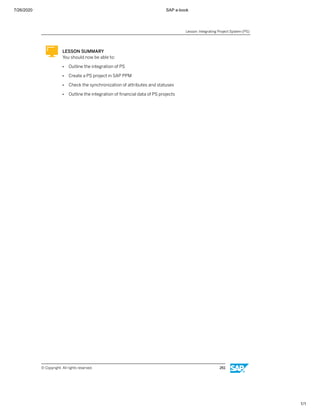

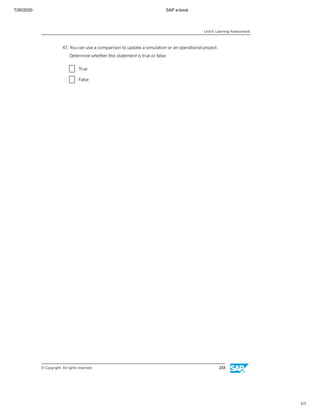

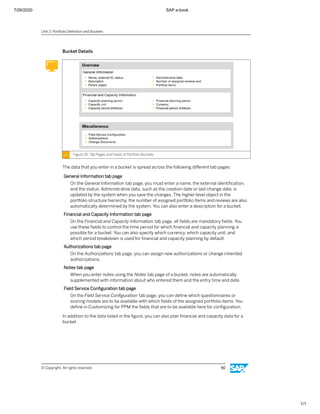

1
/ 331
2
/ 331
3
/ 331
4
/ 331
5
/ 331
6
/ 331
7
/ 331
8
/ 331
9
/ 331
10
/ 331
11
/ 331
12
/ 331
13
/ 331
14
/ 331
15
/ 331
16
/ 331
17
/ 331
18
/ 331
19
/ 331
20
/ 331
21
/ 331
22
/ 331
23
/ 331
24
/ 331
25
/ 331
26
/ 331
27
/ 331
28
/ 331
29
/ 331

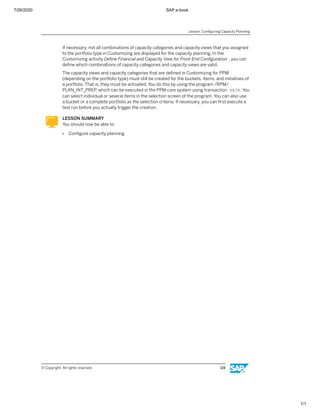

30
/ 331
31
/ 331
32
/ 331
33
/ 331
34
/ 331
35
/ 331
36
/ 331
37
/ 331
38
/ 331
39
/ 331
40
/ 331
41
/ 331
42
/ 331
43
/ 331
44
/ 331
45
/ 331
46
/ 331
47
/ 331
48
/ 331
49
/ 331
50
/ 331
51
/ 331
52
/ 331
53
/ 331
54
/ 331
55
/ 331
Most read
56
/ 331
Most read
57
/ 331
58
/ 331
59
/ 331
60
/ 331
Most read
61
/ 331
62
/ 331
63

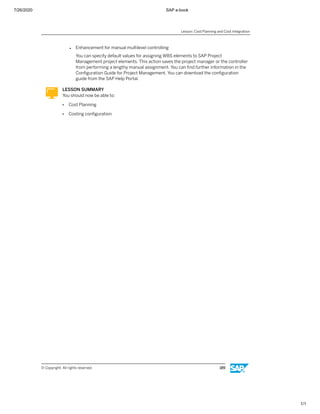

/ 331
64
/ 331
65
/ 331
66
/ 331
67
/ 331
68

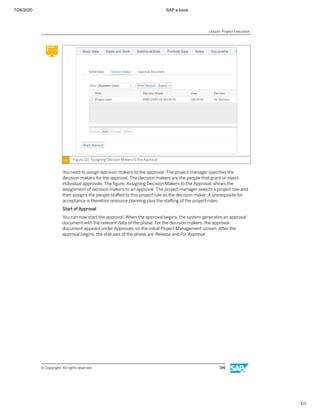

/ 331
69
/ 331
70
/ 331
71
/ 331
72
/ 331
73
/ 331
74

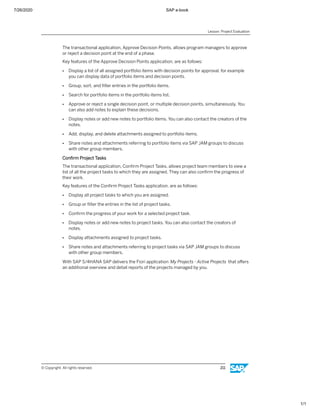

/ 331
75
/ 331
76
/ 331
77
/ 331
78
/ 331
79
/ 331
80
/ 331
81
/ 331
82
/ 331
83
/ 331
84
/ 331
85
/ 331
86
/ 331
87
/ 331

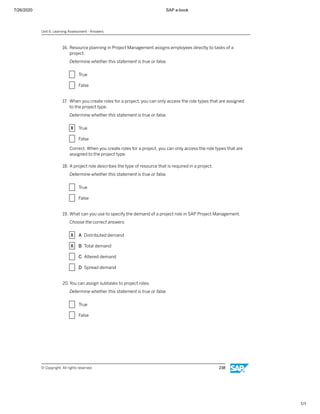

88
/ 331
89
/ 331
90
/ 331
91
/ 331
92
/ 331
93
/ 331
94
/ 331
95

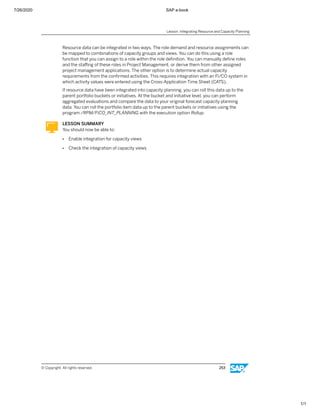

/ 331
96
/ 331
97
/ 331
98

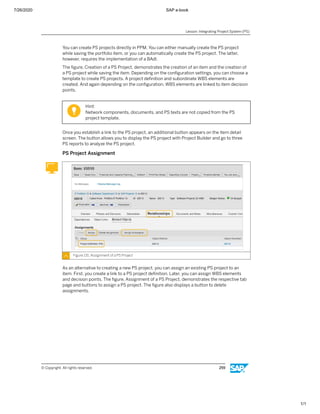

/ 331
99
/ 331
100
/ 331
101
/ 331
102
/ 331
103
/ 331
104
/ 331
105
/ 331
106
/ 331
107
/ 331
108
/ 331
109
/ 331
110
/ 331
111
/ 331
112
/ 331
113
/ 331
114
/ 331
115
/ 331
116
/ 331
117
/ 331
118
/ 331
119
/ 331
120
/ 331
121
/ 331
122
/ 331
123
/ 331
124
/ 331
125
/ 331
126
/ 331
127
/ 331
128
/ 331
129
/ 331
130
/ 331
131
/ 331
132
/ 331
133
/ 331
134
/ 331
135
/ 331
136
/ 331
137
/ 331
138
/ 331
139
/ 331
140
/ 331
141
/ 331
142
/ 331
143
/ 331
144
/ 331
145
/ 331
146
/ 331
147
/ 331
148
/ 331
149
/ 331
150
/ 331
151
/ 331
152
/ 331
153
/ 331
154
/ 331
155
/ 331
156
/ 331
157
/ 331
158
/ 331
159
/ 331
160
/ 331
161
/ 331
162
/ 331
163
/ 331
164
/ 331
165
/ 331
166
/ 331
167
/ 331
168
/ 331
169
/ 331
170
/ 331
171
/ 331
172
/ 331
173
/ 331
174
/ 331
175
/ 331
176
/ 331
177
/ 331
178
/ 331
179
/ 331
180
/ 331
181
/ 331
182
/ 331
183
/ 331
184
/ 331
185
/ 331
186
/ 331
187
/ 331
188
/ 331
189
/ 331
190
/ 331
191
/ 331
192
/ 331
193
/ 331
194
/ 331
195
/ 331
196
/ 331
197
/ 331
198
/ 331
199
/ 331
200
/ 331
201
/ 331
202
/ 331
203
/ 331
204
/ 331
205
/ 331
206
/ 331
207
/ 331
208
/ 331
209
/ 331
210
/ 331
211
/ 331
212
/ 331
213
/ 331
214
/ 331
215
/ 331
216
/ 331
217
/ 331
218
/ 331
219
/ 331
220
/ 331
221
/ 331
222
/ 331
223
/ 331
224
/ 331
225
/ 331
226
/ 331
227
/ 331
228
/ 331
229
/ 331
230
/ 331
231
/ 331
232
/ 331
233
/ 331
234
/ 331
235
/ 331
236
/ 331
237
/ 331
238
/ 331
239
/ 331
240
/ 331
241
/ 331
242
/ 331
243
/ 331
244
/ 331
245
/ 331
246
/ 331
247
/ 331
248
/ 331
249
/ 331
250
/ 331
251
/ 331
252
/ 331
253
/ 331
254
/ 331
255
/ 331
256
/ 331
257
/ 331
258
/ 331
259
/ 331
260
/ 331
261
/ 331
262
/ 331
263
/ 331
264
/ 331
265
/ 331
266
/ 331
267
/ 331
268
/ 331
269
/ 331
270
/ 331
271
/ 331
272
/ 331
273
/ 331
274
/ 331
275
/ 331
276
/ 331
277
/ 331
278
/ 331
279
/ 331
280
/ 331
281
/ 331
282
/ 331
283
/ 331
284
/ 331
285
/ 331
286
/ 331
287
/ 331
288
/ 331
289
/ 331
290
/ 331
291
/ 331
292
/ 331
293
/ 331
294
/ 331
295
/ 331
296
/ 331
297
/ 331
298
/ 331
299
/ 331
300
/ 331
301
/ 331
302
/ 331
303
/ 331
304
/ 331
305
/ 331
306
/ 331
307
/ 331
308
/ 331
309
/ 331
310
/ 331
311
/ 331
312
/ 331
313
/ 331
314
/ 331
315
/ 331
316
/ 331
317
/ 331
318
/ 331
319
/ 331
320
/ 331
321
/ 331
322
/ 331
323
/ 331
324
/ 331
325
/ 331
326
/ 331
327
/ 331
328
/ 331
329
/ 331
330
/ 331
331
/ 331
More Related Content
PDF
SAP S/4HANA Asset Management - Functions and Innovations
by
Libreria ERP
PDF
asset_16467169720871528299376665087430.pdf
by
AhmedSeid38
PDF
Business Processes in Management Accounting in SAP S/4HANA, S4F20 Col11
by
Libreria ERP
PDF
S4F03 Col11 Conversion of Accounting to SAP S/4HANA
by
Libreria ERP
PDF
Hands-on Introduction to Application Programming on SAP S/4HANA, HOS4D Col11
by
Libreria ERP
PDF
S4F12 Col11 Basics of Customizing for Financial Accounting: GL,AP, AR in SAP ...
by
Libreria ERP
PDF
S4F02 Col11 Management Accounting in SAP S/4HANA for SAP ERP CO Professionals
by
Libreria ERP
PPTX
What is SAP and what are the uses of sAP?.pptx
by
RykaBhatt
SAP S/4HANA Asset Management - Functions and Innovations
by
Libreria ERP
asset_16467169720871528299376665087430.pdf
by
AhmedSeid38
Business Processes in Management Accounting in SAP S/4HANA, S4F20 Col11
by
Libreria ERP
S4F03 Col11 Conversion of Accounting to SAP S/4HANA
by
Libreria ERP
Hands-on Introduction to Application Programming on SAP S/4HANA, HOS4D Col11
by
Libreria ERP
S4F12 Col11 Basics of Customizing for Financial Accounting: GL,AP, AR in SAP ...
by
Libreria ERP
S4F02 Col11 Management Accounting in SAP S/4HANA for SAP ERP CO Professionals
by
Libreria ERP
What is SAP and what are the uses of sAP?.pptx
by
RykaBhatt
Similar to S4125_SAP portfolio and project management functional document.pdf
PDF
SAP Central Finance Overview in SAP S/4HANA
by
Libreria ERP
PPTX
SAP Learning Hub - SAP Activate - 20 September 2016
by
Lejlaseperovic
PDF
Business Processes in Treasury and Risk Management in SAP S/4HANA
by
Libreria ERP
PDF
Business Processes in SAP S/4HANA Asset Management
by
Libreria ERP
PDF
Business Processes in SAP S/4HANA Service
by
Libreria ERP
PDF
TS460_1 Sales in SAP S/4HANA Academy Part I 1/2
by
Libreria ERP
PPTX
Sap s4 hana (2)
by
babloo6
PDF
S4F01_EN_Col17 Financial Accounting in SAP S4HANA for SAP ERP FI Professional...
by
lakshmi vara
PDF
Logisitics with SAP S/4HANA An Introduction
by
gvazque
PDF
Reporting for Finance in SAP S/4HANA, S4F07 Col09
by
Libreria ERP
PDF
Effortlessly Elegant: 10 Fashion Finds for Timeless Sophistication!
by
fadhilhafiz052
PDF
download.pdf
by
JP Chicano
PDF
Sap ac105 col03 latest simple finance 1503 sample www.erp exams_com
by
Sap Materials
PDF
sap sap S4500_Sourcing and procurement.pdf
by
FeiXue29
PDF
SAP PPM 6.0 powered by HANA
by
Espedia Consulting
PDF
S49100 Col26 Configuring Master Data for Project Control in SAP S/4HANA
by
Libreria ERP
PDF
S4601 Business Processes in SAP S/4HANA Supply Chain Execution
by
Libreria ERP
PDF
S4F00_EN_Col17 Overview of Financials in SAP S4HANA.pdf
by
lakshmi vara
PDF
Intelligent Enterprise Integration, IE900 Col01
by
Libreria ERP
PDF
SAP WalkMe Overview.pdf SAP WalkMe Overview.pdf
by
MurniatiSimbolon2
SAP Central Finance Overview in SAP S/4HANA
by
Libreria ERP
SAP Learning Hub - SAP Activate - 20 September 2016
by
Lejlaseperovic
Business Processes in Treasury and Risk Management in SAP S/4HANA
by
Libreria ERP
Business Processes in SAP S/4HANA Asset Management
by
Libreria ERP
Business Processes in SAP S/4HANA Service
by
Libreria ERP
TS460_1 Sales in SAP S/4HANA Academy Part I 1/2
by
Libreria ERP
Sap s4 hana (2)
by
babloo6
S4F01_EN_Col17 Financial Accounting in SAP S4HANA for SAP ERP FI Professional...
by
lakshmi vara
Logisitics with SAP S/4HANA An Introduction
by
gvazque
Reporting for Finance in SAP S/4HANA, S4F07 Col09
by
Libreria ERP
Effortlessly Elegant: 10 Fashion Finds for Timeless Sophistication!
by
fadhilhafiz052
download.pdf
by
JP Chicano
Sap ac105 col03 latest simple finance 1503 sample www.erp exams_com
by
Sap Materials
sap sap S4500_Sourcing and procurement.pdf
by
FeiXue29
SAP PPM 6.0 powered by HANA
by
Espedia Consulting
S49100 Col26 Configuring Master Data for Project Control in SAP S/4HANA
by
Libreria ERP
S4601 Business Processes in SAP S/4HANA Supply Chain Execution
by
Libreria ERP
S4F00_EN_Col17 Overview of Financials in SAP S4HANA.pdf
by
lakshmi vara
Intelligent Enterprise Integration, IE900 Col01
by
Libreria ERP
SAP WalkMe Overview.pdf SAP WalkMe Overview.pdf
by
MurniatiSimbolon2
Recently uploaded
PDF
Metrics, Logs, Traces, and Mayhem_ Introducing an observability adventure gam...
by
Imma Valls Bernaus
PPTX
Pitch Deck for MEVIA OS - No Apps, Infinite, Decentralized Operating System
by
Dr. Edwin Hernandez
PDF
ACE Aarhus February 2026: Atlassian news
by
DanielEriksen5
PDF
openstack_operations_slides_version1.3_pp.pdf
by
ssuser47d511
PDF
Introduction to Modern Artificial Intelligence.pdf
by
AI n Dot Net
PDF
Building Smarter AI: 16 RAG Approaches for Accuracy, Memory, and Reasoning Vi...
by
Vineet Sharma
PDF
The Ultimate Guide to Real Estate Tokenization Platforms
by
Daniel Smith
PPTX
How CFD Simulations Support Sustainable Data Center Design Optimization
by
Web Synergies
PPTX
Chapter Two Logic and Language - Copy.pptx
by
GediyonBelay
PPTX
‘Analyzing Application Logs Using AI’ Webinar
by
Tier1 app
PPTX
Installing Python in Visual Studio Code
by
dabydcatahanibmcom
PDF
Langchain4J – An Introduction for Impatient Developers
by
Juarez Junior
PDF
Doctor On Call App Development for Digital Healthcare.
by
V3CUBE TECHNOLABS
PPTX
Data Skills for Business Analysts: What You Need to Succeed
by
Scott W. Ambler
PPTX
40m_wAIred_DigitalPlatformRabobank_10022026.pptx
by
SimonedeGijt
PDF
Lost Android Phone Recovery_ Steps That Work Fast.pdf
by
Isabella Reed
PDF
Versnel innovatie met GitHub Enterprise - Rick Smit GitHub
by
Delta-N
PDF
Ontwikkel sneller en veiliger met GitHub Copilot
by
Delta-N
PDF
HuemanAI Platform Overview.pptx (1) (2).pdf
by
Ankur Handoo
PDF
Ecommerce Website Development Services - Web Panel Solutions.pdf
by
WEB PANEL SOLUTIONS
Metrics, Logs, Traces, and Mayhem_ Introducing an observability adventure gam...
by
Imma Valls Bernaus
Pitch Deck for MEVIA OS - No Apps, Infinite, Decentralized Operating System
by
Dr. Edwin Hernandez
ACE Aarhus February 2026: Atlassian news
by
DanielEriksen5
openstack_operations_slides_version1.3_pp.pdf
by
ssuser47d511
Introduction to Modern Artificial Intelligence.pdf
by
AI n Dot Net
Building Smarter AI: 16 RAG Approaches for Accuracy, Memory, and Reasoning Vi...
by
Vineet Sharma
The Ultimate Guide to Real Estate Tokenization Platforms
by
Daniel Smith
How CFD Simulations Support Sustainable Data Center Design Optimization
by
Web Synergies
Chapter Two Logic and Language - Copy.pptx
by
GediyonBelay
‘Analyzing Application Logs Using AI’ Webinar
by
Tier1 app
Installing Python in Visual Studio Code
by
dabydcatahanibmcom
Langchain4J – An Introduction for Impatient Developers
by
Juarez Junior
Doctor On Call App Development for Digital Healthcare.
by
V3CUBE TECHNOLABS
Data Skills for Business Analysts: What You Need to Succeed
by
Scott W. Ambler
40m_wAIred_DigitalPlatformRabobank_10022026.pptx
by
SimonedeGijt
Lost Android Phone Recovery_ Steps That Work Fast.pdf
by
Isabella Reed
Versnel innovatie met GitHub Enterprise - Rick Smit GitHub
by
Delta-N
Ontwikkel sneller en veiliger met GitHub Copilot
by
Delta-N
HuemanAI Platform Overview.pptx (1) (2).pdf
by
Ankur Handoo
Ecommerce Website Development Services - Web Panel Solutions.pdf
by
WEB PANEL SOLUTIONS
S4125_SAP portfolio and project management functional document.pdf
1.
7/26/2020 SAP e-book 1/1 S4125 Business
Processes in SAP S/4HANA Portfolio and Project Management . . PARTICIPANT HANDBOOK INSTRUCTOR-LED TRAINING . Course Version: 14 Course Duration: 5 Day(s) e-book Duration: 1 Day 5 Hours Material Number: 50152525
2.
7/26/2020 SAP e-book 1/1 SAP
Copyrights, Trademarks and Disclaimers © 2020 SAP SE or an SAP affiliate company. All rights reserved. No part of this publication may be reproduced or transmitted in any form or for any purpose without the express permission of SAP SE or an SAP affiliate company. SAP and other SAP products and services mentioned herein as well as their respective logos are trademarks or registered trademarks of SAP SE (or an SAP affiliate company) in Germany and other countries. Please see http:/ /global12.sap.com/ corporate-en/legal/copyright/index.epx for additional trademark information and notices. Some software products marketed by SAP SE and its distributors contain proprietary software components of other software vendors. National product specifications may vary. This course may have been machine translated and may contain grammatical errors or inaccuracies. These materials are provided by SAP SE or an SAP affiliate company for informational purposes only, without representation or warranty of any kind, and SAP SE or its affiliated companies shall not be liable for errors or omissions with respect to the materials. The only warranties for SAP SE or SAP affiliate company products and services are those that are set forth in the express warranty statements accompanying such products and services, if any. Nothing herein should be construed as constituting an additional warranty. In particular, SAP SE or its affiliated companies have no obligation to pursue any course of business outlined in this document or any related presentation, or to develop or release any functionality mentioned therein. This document, or any related presentation, and SAP SE’s or its affiliated companies’ strategy and possible future developments, products, and/or platform directions and functionality are all subject to change and may be changed by SAP SE or its affiliated companies at any time for any reason without notice. The information in this document is not a commitment, promise, or legal obligation to deliver any material, code, or functionality. All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, which speak only as of their dates, and they should not be relied upon in making purchasing decisions.
3.

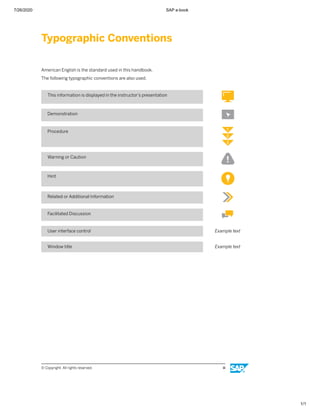

7/26/2020 SAP e-book 1/1 Typographic
Conventions American English is the standard used in this handbook. The following typographic conventions are also used. This information is displayed in the instructor’s presentation Demonstration Procedure Warning or Caution Hint Related or Additional Information Facilitated Discussion User interface control Example text Window title Example text © Copyright. All rights reserved. iii
4.
7/26/2020 SAP e-book 1/1 ©
Copyright. All rights reserved. iv
5.
7/26/2020 SAP e-book 1/1 Contents vii
Course Overview 1 Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) 2 Lesson: Introduction to SAP S/4HANA 9 Lesson: Understanding the SAP User Interface (UI) 23 Lesson: Describing PPM 31 Lesson: Describing Integration Scenarios for PPM 36 Lesson: Introduction to PPM 42 Unit 2: Portfolio Definition and Buckets 43 Lesson: Managing the Portfolio Definition 48 Lesson: Managing Portfolio Buckets 52 Lesson: Managing Classification Hierarchies 59 Unit 3: Portfolio Items and Initiatives Configuration and Creation 60 Lesson: Configuring Portfolio Items 63 Lesson: Creating Portfolio Items 67 Lesson: Creating Portfolio Initiatives 75 Unit 4: Portfolio Items and Initiatives Management 76 Lesson: Managing Authorizations 81 Lesson: Using Statuses and Workflows for Portfolio Items 85 Lesson: Using Decision Points 88 Lesson: Creating Versions of Portfolio Items 90 Lesson: Managing Reviews 98 Unit 5: Financial and Capacity Planning 100 Lesson: Planning Financial Values 106 Lesson: Configuring Financial Planning 109 Lesson: Configuring Financial Planning by Integration 112 Lesson: Planning Capacity 117 Lesson: Configuring Capacity Planning 120 Lesson: Configuring Capacity Planning by Integration © Copyright. All rights reserved. v

6.

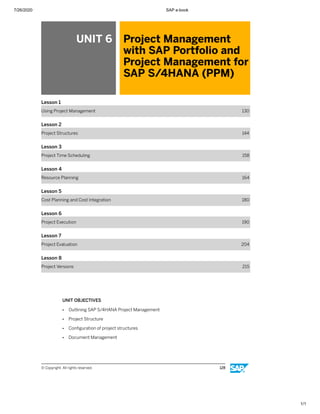

7/26/2020 SAP e-book 1/1 128
Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) 130 Lesson: Using Project Management 144 Lesson: Project Structures 158 Lesson: Project Time Scheduling 164 Lesson: Resource Planning 180 Lesson: Cost Planning and Cost Integration 190 Lesson: Project Execution 204 Lesson: Project Evaluation 215 Lesson: Project Versions 245 Unit 7: Portfolio Items and Project Management Projects 246 Lesson: Linking Portfolio Items and Project Management Projects 250 Lesson: Integrating Resource and Capacity Planning 256 Unit 8: SAP Portfolio Management and SAP Applications Integration 257 Lesson: Integrating Project System (PS) 262 Lesson: Configuring the Project System (PS) Integration 264 Lesson: Configuring the SAP Financials Integration 267 Lesson: Integrating SAP Portfolio Management with SAP ERP Financial Data 273 Lesson: Integrating SAP Innovation Management 281 Unit 9: Key Figures 282 Lesson: Using Questionnaires 286 Lesson: Using Scoring Models 292 Unit 10: Reports 293 Lesson: Reporting with SAP Analytics Cloud 295 Lesson: Reporting with Dashboards 300 Lesson: Reporting Based on Business Context Viewer (BCV) 306 Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. vi
7.
7/26/2020 SAP e-book 1/1 Course
Overview TARGET AUDIENCE This course is intended for the following audiences: ● Solution Architect ● System Administrator ● Trainer ● User © Copyright. All rights reserved. vii
8.

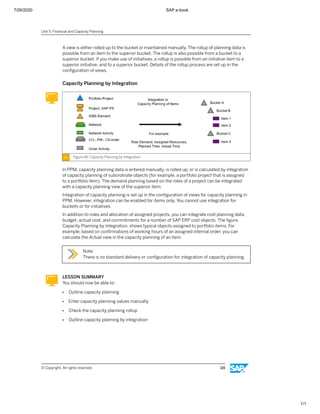

7/26/2020 SAP e-book 1/1 ©
Copyright. All rights reserved. viii

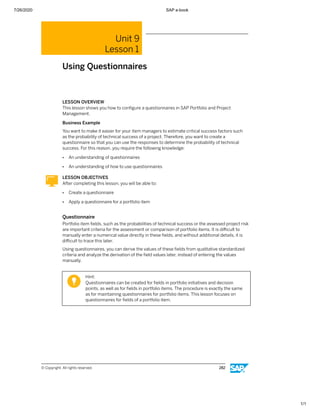

9.

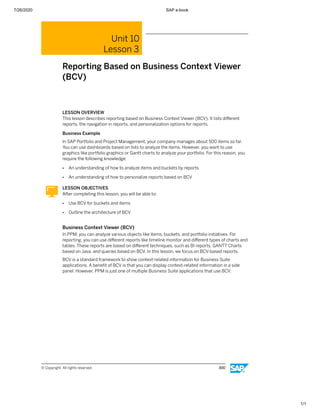

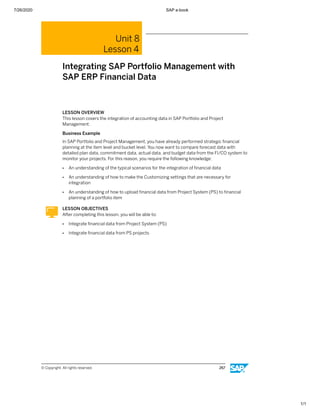

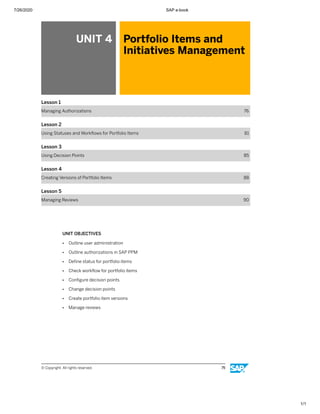

7/26/2020 SAP e-book 1/1 UNIT

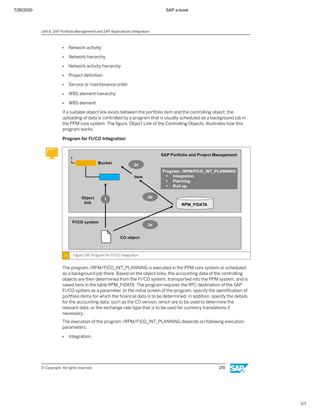

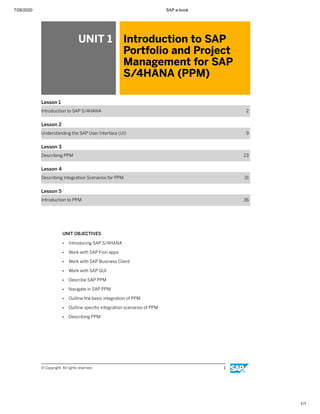

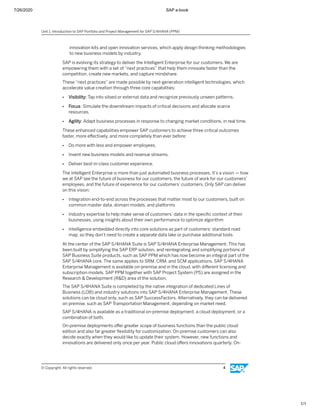

1 Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) Lesson 1 Introduction to SAP S/4HANA 2 Lesson 2 Understanding the SAP User Interface (UI) 9 Lesson 3 Describing PPM 23 Lesson 4 Describing Integration Scenarios for PPM 31 Lesson 5 Introduction to PPM 36 UNIT OBJECTIVES ● Introducing SAP S/4HANA ● Work with SAP Fiori apps ● Work with SAP Business Client ● Work with SAP GUI ● Describe SAP PPM ● Navigate in SAP PPM ● Outline the basic integration of PPM ● Outline specific integration scenarios of PPM ● Describing PPM © Copyright. All rights reserved. 1
10.
7/26/2020 SAP e-book 1/1 Unit

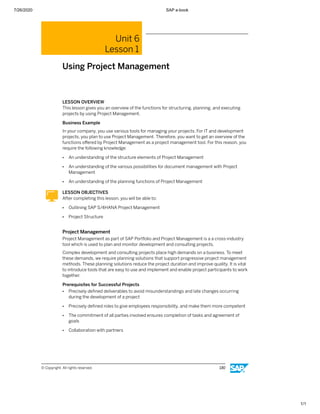

1 Lesson 1 Introduction to SAP S/4HANA LESSON OBJECTIVES After completing this lesson, you will be able to: ● Introducing SAP S/4HANA Introducing SAP S/4HANA Your enterprise plans to implement SAP S/4HANA Enterprise Portfolio and Project Management (EPPM). Therefore, you want to learn about the SAP S/4HANA Enterprise Management (Research and Development) solution. SAP S/4HANA is a relatively new product. With SAP S/4HANA, SAP are building on the success of the SAP Business Suite powered by SAP HANA with a completely new and re- imagined suite. The following are some key points: ● SAP S/4HANA runs on SAP HANA. It provides simplifications (a simplified data model with no indexes, no aggregates, and no redundancies) and innovations (an open in-memory platform for advanced applications in predicting, recommending, and simulating). ● SAP S/4HANA is natively designed with SAP Fiori UX. It offers an integrated user experience with modern usability and instant insight on any device (role-based, involves a maximum of three steps to complete the job successfully, mobile-first, and offers a consistent experience across lines of business). ● SAP S/4HANA is natively connected to the Internet of Things (IoT) and business networks for real-time collaboration in the networked economy. SAP S/4HANA is natively engineered, which provides users with a choice of deployment (on-premise, cloud, and hybrid). SAP S/4HANA is natively born for easy adoption. This means guided configuration and easy onboarding, from the discovery of the solution through cloud trials to deployment with preconfigured best practices. The classic SAP Portfolio and Project Management (PPM) and the SAP Business Suite/ SAP ERP are separate products. Both are still available. The Intelligent Enterprise For more than 45 years, SAP has been on a journey with our customers, helping them create value for their organizations by applying technology to solve some of their most complex challenges. In each era of enterprise computing, we’ve evolved our strategy – and product portfolio – so our customers can run better. In the 1960s and 1970s, as mainframe computing gained popularity, SAP enabled its first customers to automate their plant floor operations with material requirements planning software. In the 1990s, as companies expanded their use of the Internet, SAP helped connect its customers’ headquarters with their subsidiaries through SAP ® R/3® software for enterprise resource planning. Over the past 10 years, as cloud computing and Big Data have © Copyright. All rights reserved. 2
11.
7/26/2020 SAP e-book 1/1 become
ever more pervasive, SAP HANA ® software, along with SAP's extensive portfolio of cloud applications, has helped SAP's customers begin their own digital transformations. Now, as technologies such as artificial intelligence, machine learning, the Internet of Things (IoT), advanced analytics and blockchain become mainstream, SAP has a new opportunity – to help turn its customers’ businesses into intelligent enterprises, with new capabilities that enable their workforces to focus on higher-value outcomes. Advances in machine learning are enabling algorithms to become highly accurate in natural language understanding and in image and speech recognition. Businesses can use these increasingly sophisticated capabilities to drive the next level of intelligent business processes automation and eliminate repetitive manual tasks. Automation can now also be implemented far more cost-effectively, because it is embedded more and more within business processes. All of this means that the workforce are able to focus on high-value activities such as customer success, strategic planning, and innovation. Advances in ubiquitous connectivity and edge computing are creating a step change in business productivity. This connectivity, coupled with artificial intelligence and machine learning, can be used to analyze petabytes of data to affect real business outcomes. IoT can connect the entire value chain, from design to production to supply chain, and data-driven insights of customer preferences can inspire better design, lower material costs, and reduce risk. Real-time analysis of machines can predict maintenance needs, identify potential quality problems in manufacturing processes before they occur, and reduce asset downtime by as much as 50%.The integration of advanced analytics capabilities into applications allows business users to analyze data on the fly and informs better decision-making. Empowered users, benefiting from embedded analytics in business processes, can get real-time visibility into their changing environment, simulate the impact of business decisions, and achieve better customer outcomes. The global economic growth of the last nine years has been powered largely by technology. Record corporate profits and new business models can all be tied to technology-driven innovation. On average, an S&P 500 company is now being replaced once every two weeks. This “tumble rate” is accelerating, with the difference between winners and losers tied to their ability to embrace digital technologies. The next decade will, of course, bring about even greater tectonic shifts. To address these challenges, businesses need to make sense of a growing volume of data, create a step change in productivity, and innovate with relentless clock-speed. In other words, they need to accelerate value creation. This is the heart of the Intelligent Enterprise. To help businesses become Intelligent Enterprises and achieve breakthrough outcomes, SAP provides three essential components: 1. Intelligent Suite: Offers unparalleled, breakthrough business value. We provide intelligent, integrated applications that enable our customers to automate their day-today business processes and better interact with their customers, suppliers, and employees. These applications will be industry specific, global, and applicable to large enterprises and to small and midsize enterprises. 2. Digital Platform: Enables data-driven intelligence and innovation. With SAP Cloud Platform and SAP HANA Data Management Suite, we facilitate the collection, connection and orchestration of data, as well as the integration and extension of processes within the intelligent suite. 3. Intelligent Technologies : Embeds intelligence in applications and facilitate new co- innovations. With SAP Leonardo, we embed intelligent technologies in our customers’ core processes, enabling them to use their data to detect patterns, predict outcomes, and suggest actions. For customers who want to innovate even faster, we offer industry Lesson: Introduction to SAP S/4HANA © Copyright. All rights reserved. 3
12.
7/26/2020 SAP e-book 1/1 innovation

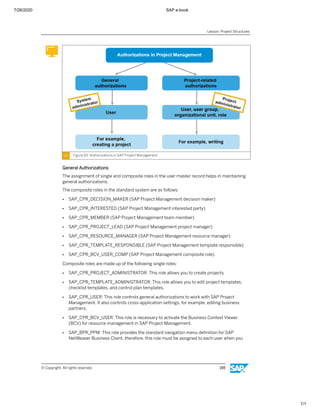

kits and open innovation services, which apply design thinking methodologies to new business models by industry. SAP is evolving its strategy to deliver the Intelligent Enterprise for our customers. We are empowering them with a set of “next practices” that help them innovate faster than the competition, create new markets, and capture mindshare. These “next practices” are made possible by next-generation intelligent technologies, which accelerate value creation through three core capabilities: ● Visibility: Tap into siloed or external data and recognize previously unseen patterns. ● Focus: Simulate the downstream impacts of critical decisions and allocate scarce resources. ● Agility: Adapt business processes in response to changing market conditions, in real time. These enhanced capabilities empower SAP customers to achieve three critical outcomes faster, more effectively, and more completely than ever before: ● Do more with less and empower employees. ● Invent new business models and revenue streams. ● Deliver best-in-class customer experience. The Intelligent Enterprise is more than just automated business processes. It’s a vision — how we at SAP see the future of business for our customers, the future of work for our customers’ employees, and the future of experience for our customers’ customers. Only SAP can deliver on this vision: ● Integration end-to-end across the processes that matter most to our customers, built on common master data, domain models, and platforms ● Industry expertise to help make sense of customers’ data in the specific context of their businesses, using insights about their own performance to optimize algorithm ● Intelligence embedded directly into core solutions as part of customers’ standard road map, so they don’t need to create a separate data lake or purchase additional tools At the center of the SAP S/4HANA Suite is SAP S/4HANA Enterprise Management. This has been built by simplifying the SAP ERP solution, and reintegrating and simplifying portions of SAP Business Suite products, such as SAP PPM which has now become an integral part of the SAP S/4HANA core. The same applies to SRM, CRM, and SCM applications. SAP S/4HANA Enterprise Management is available on-premise and in the cloud, with different licensing and subscription models. SAP PPM together with SAP Project System (PS) are assigned in the Research & Development (R&D) area of the solution. The SAP S/4HANA Suite is completed by the native integration of dedicated Lines of Business (LOB) and industry solutions into SAP S/4HANA Enterprise Management. These solutions can be cloud only, such as SAP SuccessFactors. Alternatively, they can be delivered on premise, such as SAP Transportation Management, depending on market need. SAP S/4HANA is available as a traditional on-premise deployment, a cloud deployment, or a combination of both. On-premise deployments offer greater scope of business functions than the public cloud edition and also far greater flexibility for customization. On-premise customers can also decide exactly when they would like to update their system. However, new functions and innovations are delivered only once per year. Public cloud offers innovations quarterly. On- Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 4
13.
7/26/2020 SAP e-book 1/1 premise
also means the entire application and infrastructure is owned and managed by the customer A private cloud deployment means that the customer does not share the applications and platform with other customers, but has their own private SAP S/4HANA application and platform. This is technically an on-premise edition of SAP S/4HANA, but it is completely managed by SAP or hosting partners. The same rules apply as for the on-premise edition. Deeper customizations are possible and the customer can decide exactly when updates are applied. Innovations are available annually. A public cloud deployment of SAP S/4HANA means that customers share the applications and platform with other customers. Each customer's data is strictly isolated, and each customer has their own technical container. Customers do not affect each other regarding performance of the system. The public cloud edition of SAP S/4HANA contains essential standard core process functionality that, for most customers, is more than enough. However, it is not as comprehensive in scope as the on-premise edition. Although each customer uses the standard software, light customizations are possible, for example, to add fields to screens, define new reports, and so on. All new SAP S/4HANA innovations are released for cloud before the on-premise edition and are delivered in quarterly cycles. With the public cloud option, customers must adopt the new innovations immediately, because they do not control the release of new functions. This edition is the type of product known as Software as a Service (SaaS). SAP S/4HANA Cloud, single tenant edition is provisioned to a single customer in a dedicated landscape, offering the full scope of S/4HANA. However, because of the character of the provisioning, the implementation of SAP S/4HANA Cloud, single tenant edition might lead to higher total cost of ownership (TCO) and slightly slower speed of innovation and time-to-value when compared to a SAP S/4HANA Cloud implementation. Therefore, customers who consider the implementation of a cloud solution should first discover and verify the capabilities of SAP S/4HANA Cloud. If the standard best practices and functional scope does not meet all of the customer's requirements, S/4HANA Cloud, single tenant edition could be an ideal substitute solution in the customer’s journey to move to the cloud. SAP S/4HANA Cloud, single tenant edition offers additional features compared to SAP S/ 4HANA Cloud: ● Configurable and customizable process up to a certain extent for Finance, HR, Procurement, Sales and other LoBs ● Support of industries, including the ones that are not supported by S/4HANA Cloud ● Two upgrades each year, upgrade window can be chosen by the customer ● Option to choose from different data centers across the globe to manage the solution ● Flexible license system ● Dedicated System Landscape on Cloud Infrastructure ● Integration with public cloud systems and on-premises systems are fully supported All cloud deployments offer an annual, subscription-based pricing model, so customers pay for what they need and can add to it later. On-premise continues with the traditional licensing model. Lesson: Introduction to SAP S/4HANA © Copyright. All rights reserved. 5
14.
7/26/2020 SAP e-book 1/1 It

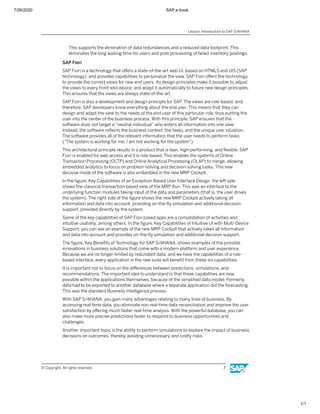

is clear that technology is disruptive. This is precisely why we need to engage with digital transformation. Driven by the combination of ever-growing digitization and evolving consumer demands, digital transformation is the use of new technologies to drive significant business improvements. This includes capitalizing on new opportunities and effectively transforming existing business. If you look at the numbers in the figure, Increasingly Complex and Networked Business Landscape, it is apparent that the world around us is becoming more complex. Here are some reasons for this increasing complexity: ● Exponential growth of digital information, that is, social, mobile, and big data ● Globalization and spread of business networks ● Internet of Things (IoT) So far, the response has involved more complex business processes, more complex organizations, and more complex software solutions. At the end of 2009, 5% of the world's population owned smartphones. Four years later, that figure jumped to 22%. Currently, 1.7 billion people are on social networks. Over the next three years, that audience will grow to surpass 2.55 billion. By 2020, 5 million people will enter the middle class and come online, while 50 billion devices will be connected to the IoT, creating a digital network of virtually everything. Cloud computing, which was a $41 billion business in 2011, will grow to be a $241 billion business in the same time-frame. The proliferation of mobile devices, social media, cloud technologies, and the excessive amounts of data that they generate has transformed the way that we live and work. 61% of companies report that most of their employees use smart devices for everything from email to project management and content creation. While these advancements have improved lives and provided greater opportunities for innovation, they also accelerated the rise of an entirely new problem: unprecedented and crippling complexity. The world may be getting smarter but it has not become easier. With SAP S/4HANA Enterprise management, core ERP and PPM processes remain stable. A project is still a project with a scheduled timeline, phases, tasks, and worklists to be performed. There is still calculation done in Controlling and project employees record their working times. However, the technical environment has changed. The innovations in SAP S/4HANA are based on the following four pillars: ● Reporting and analysis Data is stored in its finest granularity. Data is semantically integrated and easy-to- consume (no redundancies or aggregates). There is no latency to SAP BW. ● Scalable infrastructure Trends include cloud, system consolidation on-premise, new services (for example, localization), and new devices. These trends are supported by scale-out and the reduction of memory footprint (SAP HANA columnar). ● User experience This supports user productivity. For example, Nestle has several thousand users for central roles, with an assumed productivity increase of 10%, which is an immediate business case. This also supports aspects such as multiple devices and analytics. ● Increased throughput Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 6
15.
7/26/2020 SAP e-book 1/1 This
supports the elimination of data redundancies and a reduced data footprint. This eliminates the long waiting time for users and post-processing of failed inventory postings. SAP Fiori SAP Fiori is a technology that offers a state-of-the-art web UI, based on HTML5 and UI5 (SAP technology), and provides capabilities to personalize the view. SAP Fiori offers the technology to provide the correct views for new end users. Its design principles make it possible to adjust the views to every front-end device, and adapt it automatically to future new design principles. This ensures that the views are always state-of-the-art. SAP Fiori is also a development and design principle for SAP. The views are role-based, and, therefore, SAP developers know everything about the end user. This means that they can design and adapt the view to the needs of the end user of this particular role, thus putting the user into the center of the business process. With this principle, SAP ensures that the software does not target a “neutral individual” who enters all information into one view. Instead, the software reflects the business context, the tasks, and the unique user situation. The software provides all of the relevant information that the user needs to perform tasks ("The system is working for me; I am not working for the system"). This architectural principle results in a product that is lean, high-performing, and flexible. SAP Fiori is enabled for web access and it is role-based. This enables the systems of Online Transaction Processing (OLTP) and Online Analytical Processing (OLAP) to merge, allowing embedded analytics to focus on problem-solving and decision-solving tasks. This new decisive mode of the software is also embedded in the new MRP Cockpit. In the figure, Key Capabilities of an Exception-Based User Interface Design, the left side shows the classical transaction-based view of the MRP Run. This was an interface to the underlying function modules taking input of the data and parameters (that is, the user drives the system). The right side of the figure shows the new MRP Cockpit actively taking all information and data into account, providing on-the-fly simulation and additional decision support, provided directly by the system. Some of the key capabilities of SAP Fiori based apps are a consolidation of activities and intuitive usability, among others. In the figure, Key Capabilities of Intuitive UI with Multi-Device Support, you can see an example of the new MRP Cockpit that actively takes all information and data into account and provides on-the-fly simulation and additional decision support. The figure, Key Benefits of Technology for SAP S/4HANA, shows examples of the possible innovations in business solutions that come with a modern platform and user experience. Because we are no longer limited by redundant data, and we have the capabilities of a role- based interface, every application in the new suite will benefit from these six capabilities. It is important not to focus on the differences between predictions, simulations, and recommendations. The important idea to understand is that these capabilities are now possible within the applications themselves, because of the simplified data model. Formerly, data had to be exported to another database where a separate application did the forecasting. This was the standard Business Intelligence process. With SAP S/4HANA, you gain many advantages relating to many lines of business. By accessing real-time data, you eliminate non real-time data reconciliation and improve the user satisfaction by offering much faster real-time analysis. With the powerful database, you can also make more precise predictions faster to respond to business opportunities and challenges. Another important topic is the ability to perform simulations to explore the impact of business decisions on outcomes, thereby avoiding unnecessary and costly risks. Lesson: Introduction to SAP S/4HANA © Copyright. All rights reserved. 7
16.
7/26/2020 SAP e-book 1/1 Further
information on SAP S/4HANA Enterprise Management For further information on SAP S/4HANA Enterprise Management, check the following locations: ● SAP S/4HANA training : Visit our webshop at http:/ /training.sap.com. ● SAP S/4HANA documentation: Visit our help portal at http:/ /help.sap.com. ● Simplification list: Visit our help portal at https:/ /help.sap.com/s4hana_op_1909. ● Conversion guide: Visit our help portal at https:/ /help.sap.com/s4hana_op_1909. ● SAP Fiori: Visit Experience SAP at https:/ /experience.sap.com/fiori. LESSON SUMMARY You should now be able to: ● Introducing SAP S/4HANA Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 8

17.

7/26/2020 SAP e-book 1/1 Unit

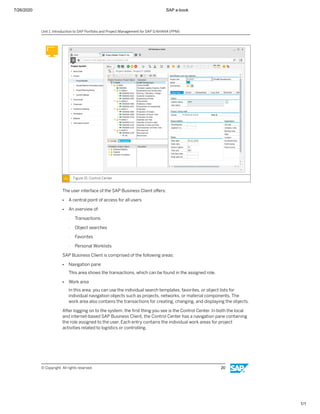

1 Lesson 2 Understanding the SAP User Interface (UI) LESSON OBJECTIVES After completing this lesson, you will be able to: ● Work with SAP Fiori apps ● Work with SAP Business Client ● Work with SAP GUI SAP Fiori User Experience As your enterprise plans to implement SAP S/4HANA, you want to learn more about the SAP user experience strategy, and, particularly, the SAP Fiori UI. Concepts and Influencing Factors Figure 1: Concepts and Influencing Factors IT and the use of electronic devices is no longer reserved for a group of experts. It has spread throughout all social groups. In this context, high performing hardware stands against a wide variety of software products with differing scope and potential. This puts stress on ease of use from the perspective of the end user. The main drivers of this development are smartphones © Copyright. All rights reserved. 9
18.

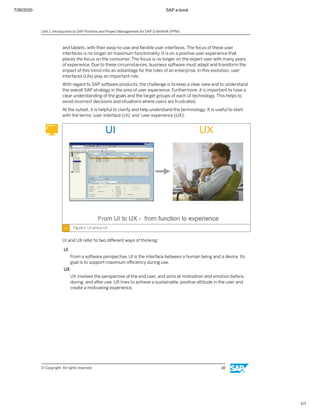

7/26/2020 SAP e-book 1/1 and
tablets, with their easy-to-use and flexible user interfaces. The focus of these user interfaces is no longer on maximum functionality. It is on a positive user experience that places the focus on the consumer. The focus is no longer on the expert user with many years of experience. Due to these circumstances, business software must adapt and transform the impact of this trend into an advantage for the roles of an enterprise. In this evolution, user interfaces (UIs) play an important role. With regard to SAP software products, the challenge is to keep a clear view and to understand the overall SAP strategy in the area of user experience. Furthermore, it is important to have a clear understanding of the goals and the target groups of each UI technology. This helps to avoid incorrect decisions and situations where users are frustrated. At the outset, it is helpful to clarify and help understand the terminology. It is useful to start with the terms 'user interface (UI)' and 'user experience (UX)'. Figure 2: UI versus UX UI and UX refer to two different ways of thinking: UI From a software perspective, UI is the interface between a human being and a device. Its goal is to support maximum efficiency during use. UX UX involves the perspective of the end user, and aims at motivation and emotion before, during, and after use. UX tries to achieve a sustainable, positive attitude in the user and create a motivating experience. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 10

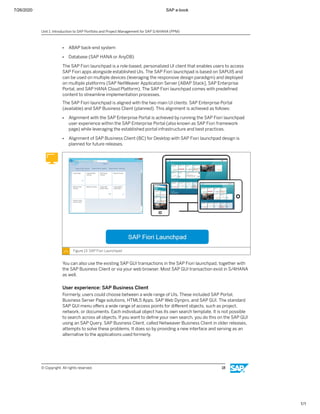

19.

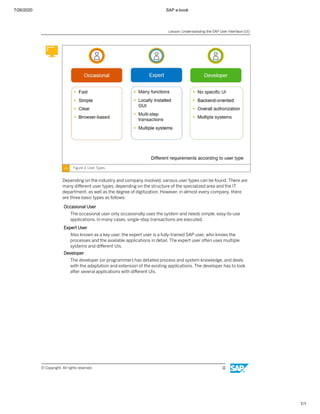

7/26/2020 SAP e-book 1/1 Figure
3: User Types Depending on the industry and company involved, various user types can be found. There are many different user types, depending on the structure of the specialized area and the IT department, as well as the degree of digitization. However, in almost every company, there are three basic types as follows: Occasional User The occasional user only occasionally uses the system and needs simple, easy-to-use applications. In many cases, single-step transactions are executed. Expert User Also known as a key user, the expert user is a fully-trained SAP user, who knows the processes and the available applications in detail. The expert user often uses multiple systems and different UIs. Developer The developer (or programmer) has detailed process and system knowledge, and deals with the adaptation and extension of the existing applications. The developer has to look after several applications with different UIs. Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 11

20.

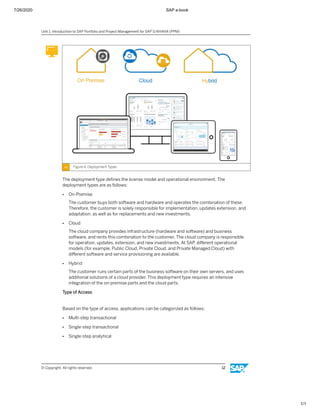

7/26/2020 SAP e-book 1/1 Figure
4: Deployment Types The deployment type defines the license model and operational environment. The deployment types are as follows: ● On-Premise The customer buys both software and hardware and operates the combination of these. Therefore, the customer is solely responsible for implementation, updates extension, and adaptation, as well as for replacements and new investments. ● Cloud The cloud company provides infrastructure (hardware and software) and business software, and rents this combination to the customer. The cloud company is responsible for operation, updates, extension, and new investments. At SAP, different operational models (for example, Public Cloud, Private Cloud, and Private Managed Cloud) with different software and service provisioning are available. ● Hybrid The customer runs certain parts of the business software on their own servers, and uses additional solutions of a cloud provider. This deployment type requires an intensive integration of the on-premise parts and the cloud parts. Type of Access Based on the type of access, applications can be categorized as follows: ● Multi-step transactional ● Single-step transactional ● Single-step analytical Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 12
21.
7/26/2020 SAP e-book 1/1 Figure

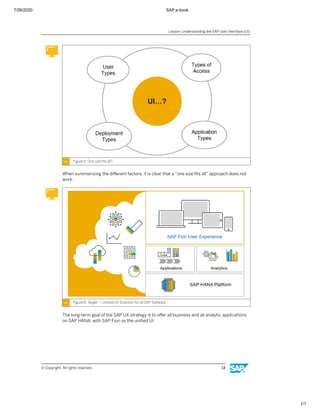

5: One size fits all? When summarizing the different factors, it is clear that a “one size fits all” approach does not work. Figure 6: Target — Unified UX Direction for all SAP Software The long-term goal of the SAP UX strategy is to offer all business and all analytic applications on SAP HANA, with SAP Fiori as the unified UI. Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 13
22.
7/26/2020 SAP e-book 1/1 Figure

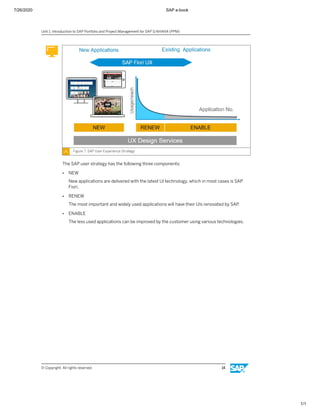

7: SAP User Experience Strategy The SAP user strategy has the following three components: ● NEW New applications are delivered with the latest UI technology, which in most cases is SAP Fiori. ● RENEW The most important and widely used applications will have their UIs renovated by SAP. ● ENABLE The less used applications can be improved by the customer using various technologies. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 14

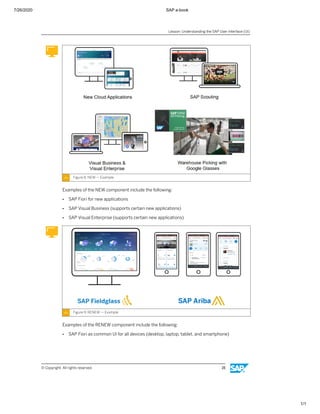

23.

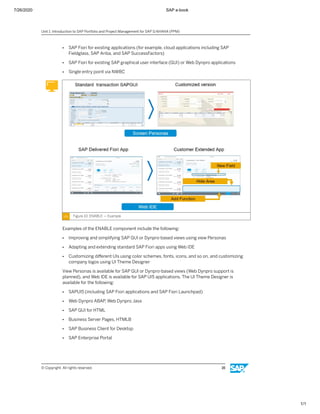

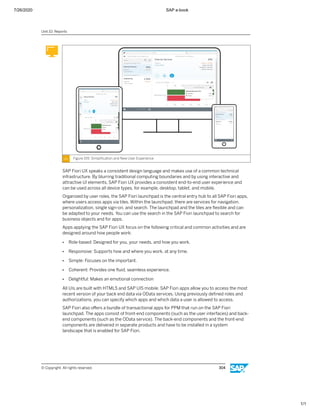

7/26/2020 SAP e-book 1/1 Figure
8: NEW — Example Examples of the NEW component include the following: ● SAP Fiori for new applications ● SAP Visual Business (supports certain new applications) ● SAP Visual Enterprise (supports certain new applications) Figure 9: RENEW — Example Examples of the RENEW component include the following: ● SAP Fiori as common UI for all devices (desktop, laptop, tablet, and smartphone) Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 15
24.
7/26/2020 SAP e-book 1/1 ●
SAP Fiori for existing applications (for example, cloud applications including SAP Fieldglass, SAP Ariba, and SAP SuccessFactors) ● SAP Fiori for existing SAP graphical user interface (GUI) or Web Dynpro applications ● Single entry point via NWBC Figure 10: ENABLE — Example Examples of the ENABLE component include the following: ● Improving and simplifying SAP GUI or Dynpro-based views using view Personas ● Adapting and extending standard SAP Fiori apps using Web IDE ● Customizing different UIs using color schemes, fonts, icons, and so on, and customizing company logos using UI Theme Designer View Personas is available for SAP GUI or Dynpro-based views (Web Dynpro support is planned), and Web IDE is available for SAP UI5 applications. The UI Theme Designer is available for the following: ● SAPUI5 (including SAP Fiori applications and SAP Fiori Launchpad) ● Web Dynpro ABAP, Web Dynpro Java ● SAP GUI for HTML ● Business Server Pages, HTMLB ● SAP Business Client for Desktop ● SAP Enterprise Portal Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 16
25.
7/26/2020 SAP e-book 1/1 Figure
11: Types of SAP Fiori Apps Transactional SAP Fiori apps need an ABAP environment and are often used for single-step transactions. Analytical apps and Fact Sheets are SAP HANA-based, and often contain new functionality. Figure 12: SAP Fiori Architecture The SAP Fiori architecture consists of the following levels: ● HTML5 client (SAP Fiori launchpad) ● ABAP front-end server, with a central UI component and SAP Fiori roles implemented Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 17
26.
7/26/2020 SAP e-book 1/1 ●

ABAP back-end system ● Database (SAP HANA or AnyDB) The SAP Fiori launchpad is a role-based, personalized UI client that enables users to access SAP Fiori apps alongside established UIs. The SAP Fiori launchpad is based on SAPUI5 and can be used on multiple devices (leveraging the responsive design paradigm) and deployed on multiple platforms (SAP NetWeaver Application Server [ABAP Stack], SAP Enterprise Portal, and SAP HANA Cloud Platform). The SAP Fiori launchpad comes with predefined content to streamline implementation processes. The SAP Fiori launchpad is aligned with the two main UI clients: SAP Enterprise Portal (available) and SAP Business Client (planned). This alignment is achieved as follows: ● Alignment with the SAP Enterprise Portal is achieved by running the SAP Fiori launchpad user experience within the SAP Enterprise Portal (also known as SAP Fiori framework page) while leveraging the established portal infrastructure and best practices. ● Alignment of SAP Business Client (BC) for Desktop with SAP Fiori launchpad design is planned for future releases. Figure 13: SAP Fiori Launchpad You can also use the existing SAP GUI transactions in the SAP Fiori launchpad, together with the SAP Business Client or via your web browser. Most SAP GUI transaction exist in S/4HANA as well. User experience: SAP Business Client Formerly, users could choose between a wide range of UIs. These included SAP Portal, Business Server Page solutions, HTML5 Apps, SAP Web Dynpro, and SAP GUI. The standard SAP GUI menu offers a wide range of access points for different objects, such as project, network, or documents. Each individual object has its own search template. It is not possible to search across all objects. If you want to define your own search, you do this on the SAP GUI using an SAP Query. SAP Business Client, called Netweaver Business Client in older releases, attempts to solve these problems. It does so by providing a new interface and serving as an alternative to the applications used formerly. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 18
27.

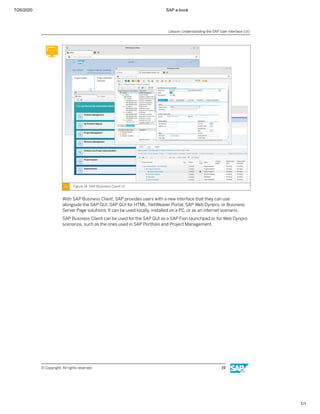

7/26/2020 SAP e-book 1/1 Figure
14: SAP Business Client UI With SAP Business Client, SAP provides users with a new interface that they can use alongside the SAP GUI, SAP GUI for HTML, NetWeaver Portal, SAP Web Dynpro, or Business Server Page solutions. It can be used locally, installed on a PC, or as an internet scenario. SAP Business Client can be used for the SAP GUI as a SAP Fiori launchpad or for Web Dynpro scenarios, such as the ones used in SAP Portfolio and Project Management. Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 19
28.
7/26/2020 SAP e-book 1/1 Figure
15: Control Center The user interface of the SAP Business Client offers: ● A central point of access for all users ● An overview of: - Transactions - Object searches - Favorites - Personal Worklists SAP Business Client is comprised of the following areas: ● Navigation pane This area shows the transactions, which can be found in the assigned role. ● Work area In this area, you can use the individual search templates, favorites, or object lists for individual navigation objects such as projects, networks, or material components. The work area also contains the transactions for creating, changing, and displaying the objects. After logging on to the system, the first thing you see is the Control Center. In both the local and internet-based SAP Business Client, the Control Center has a navigation pane containing the role assigned to the user. Each entry contains the individual work areas for project activities related to logistics or controlling. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 20
29.

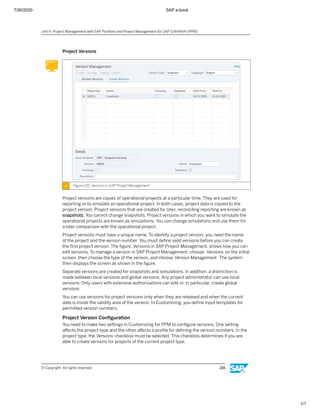

7/26/2020 SAP e-book 1/1 Figure
16: Control Center vs. SAP FIori Launchpad Alternatively, you can access the SAP Fiori launchpad in the SAP Business Client and start the HTML5 transactions there. User Experience: SAP GUI The SAP graphical user interface (GUI) is the front-end program used to access SAP systems. Several variants of the SAP GUI are available and are adapted for use in different environments. The SAP GUI program connects the front-end computer to a specific SAP system. To start the SAP GUI, SAP provides another program, SAP Logon. When the user launches SAP Logon, a screen displays a list of available SAP systems. This list is derived from a file on the front-end computer, and is preconfigured and made available to users. SAP Easy Access When you work with your SAP S/4 HANA system, you can start the SAP Easy Access menu. Here, you can select transactions via a menu path or through executing the transaction code. If you migrated your “old” SAP ECC system to SAP S/4 HANA, you could opt to work with the classic SAP GUI transactions. The Choice is Yours The system access is your choice. Most SAP S/4HANA scenarios can be reached via the SAP Fiori launchpad. Alternatively, you can use SAP Business Client with standard Web Dynpro or the SAP GUI for HTML transactions. If users don’t want to work with SAP Fiori or SAP Business Client, they are still able to open the classic SAP transactions. Lesson: Understanding the SAP User Interface (UI) © Copyright. All rights reserved. 21
30.
7/26/2020 SAP e-book 1/1 Figure

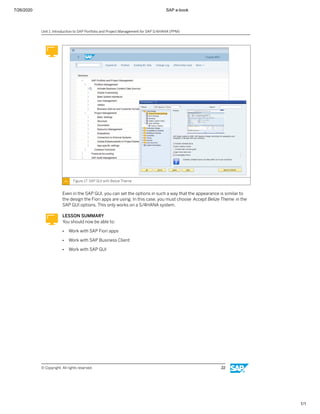

17: SAP GUI with Belize Theme Even in the SAP GUI, you can set the options in such a way that the appearance is similar to the design the Fiori apps are using. In this case, you must choose Accept Belize Theme in the SAP GUI options. This only works on a S/4HANA system. LESSON SUMMARY You should now be able to: ● Work with SAP Fiori apps ● Work with SAP Business Client ● Work with SAP GUI Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 22
31.
7/26/2020 SAP e-book 1/1 Unit

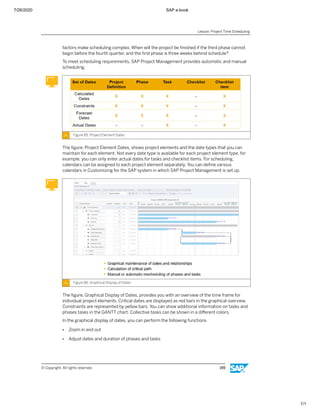

1 Lesson 3 Describing PPM LESSON OVERVIEW This lesson gives an understanding of the various structure objects of SAP Portfolio and Project Management and explains the possibilities of integrating these with external applications. Business Example You are responsible for the IT department of your company. You need a tool that will help monitor the IT projects and make decisions about the realization and development of these projects. For this reason, you require the following knowledge: ● An understanding of the benefits of SAP Portfolio and Project Management ● An understanding of the key functions of SAP Portfolio and Project Management LESSON OBJECTIVES After completing this lesson, you will be able to: ● Describe SAP PPM ● Navigate in SAP PPM SAP Portfolio and Project Management (PPM) Figure 18: Portfolio Item Dashboard in SAP Portfolio and Project Management Successful companies distinguish themselves from others by aligning their entire portfolio with the strategic goals of the company. This applies practically to the introduction of a new product or to companies in which project-based business processes play a central role. For finance and resource-intensive projects, it is important to recognize profitable projects and to monitor and control these accordingly. © Copyright. All rights reserved. 23
32.
7/26/2020 SAP e-book 1/1 Structure
of a Portfolio in SAP PPM Figure 19: Structure of a Portfolio in PPM SAP PPM is a tool that supports companies in their strategic and operative portfolio management. SAP PPM enables you to manage several portfolios such as product innovations, service industries, and IT initiatives. It can combine data from various project management, human resources management, and financial systems. This enables new cross- functional business processes and the ability to have an extensive overview of all business processes. Strategic and Operative Portfolio Management Figure 20: Reporting Cockpit in SAP Portfolio and Project Management Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 24
33.

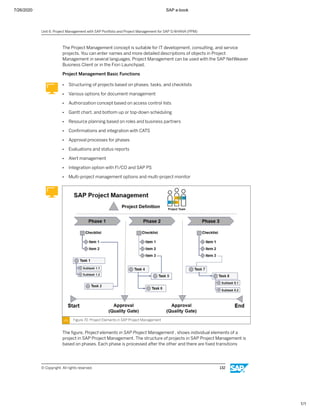

7/26/2020 SAP e-book 1/1 The

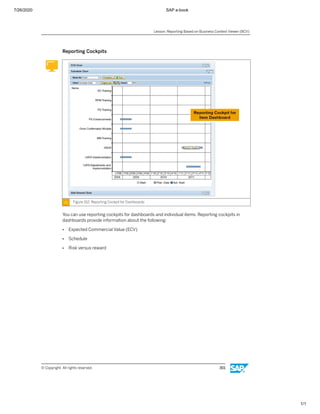

figure, Reporting Cockpit in SAP Portfolio and Project Management, shows a schedule chart with the forecasted, planned, and actual starts of your projects. Figure 21: Reporting Cockpit in SAP Portfolio and Project Management 2 The figure, Reporting Cockpit in SAP Portfolio and Project Management 2, shows how SAP Portfolio and Project Management displays an ECV chart of your projects. SAP Portfolio and Project Management Help With Objectives SAP Portfolio and Project Management helps you to overcome the challenges of strategic and operative portfolio management. ● Align your portfolio with your corporate goals With SAP Portfolio and Project Management, your portfolio items and initiatives are regularly assessed according to their exact strategic value, and your commercial success is proven and accelerated. ● Maximize the value of your portfolio You can select the most promising portfolio items and guarantee steady success. At the same time, you can ensure a balanced portfolio with acceptable risks, dynamic business targets, and various investment types. ● Create more transparency and make informed decisions SAP Portfolio and Project Management combines data from SAP and external systems, so that underachieving or overlapping projects and capacity bottlenecks can be quickly recognized and adjusted. ● Use your resources more effectively Lesson: Describing PPM © Copyright. All rights reserved. 25

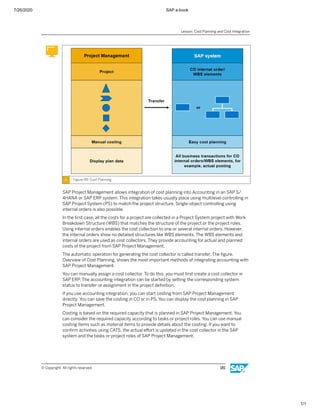

34.
7/26/2020 SAP e-book 1/1 SAP

Portfolio and Project Management helps you track and prioritize resource requests from various project management systems, and reconcile the availability specified in the Human Capital Management (HCM) and financial systems. In this way, you can find suitable resources (internal or external), lower costs, and benefit from the optimum personnel assignment of your projects. ● Control your portfolio more efficiently Using automated role-specific workflows, you can optimize approval procedures, resource allocations, or successive evaluations. A strict workflow-based process control allows you to implement investment guidelines throughout the company for product developments or IT projects. ● Reduce your total cost of ownership SAP Portfolio and Project Management can be integrated with many back-end systems from SAP. In this way, you can continue to optimize existing IT systems and available skills. Business Functions in Portfolio Management Figure 22: Financial Planning with SAP Portfolio and Project Management SAP Portfolio and Project Management offers many functions that support you in managing your portfolios. Key Functions of SAP Portfolio and Project Management Some of the key functions of SAP Portfolio and Project Management are as follows: ● Portfolio definition You can define several portfolios and subdivide portfolios hierarchically according to your own requirements by using portfolio buckets. This means you can monitor your portfolio items such as projects or product initiatives in an overview. The use of collections, reviews, or initiatives allows you to manage portfolio items of different portfolio buckets of a portfolio at the same time if necessary. ● Questionnaires and Scoring Models You can define your own questionnaires to determine critical success factors for your portfolio items and initiatives. Using your own scoring model, critical success factors can Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 26
35.
7/26/2020 SAP e-book 1/1 be
automatically derived from the portfolio item data and then used for prioritizing. These functions allow you to align your portfolios with your corporate goals. ● Financial and Capacity Planning For the purpose of forecasting or for strategic planning, you can enter financial and capacity data at the level of portfolio buckets, individual portfolio items, or initiatives. You can then compare these data with detailed planning values or actual data, which can be combined in SAP Portfolio and Project Management from SAP ERP and Project Systems. ● Control Reviews allow you to make decisions about portfolio items in SAP Portfolio and Project Management. For example, you can decide which IT projects should be implemented or which projects can be canceled. If necessary, you can also use simulations and what-if analyses to discuss alternative scenarios for portfolio items. Using individual decision points and versions, you can control and trace the flow of your portfolio items. Using workflows, you can also ensure that changes are communicated and therefore, your company’s guidelines are followed. ● Integration You can link various project management systems such as Project System, Project Management, or Microsoft Project with SAP Portfolio and Project Management to uniformly monitor structural, date-related, or resource information. The unification of resource data also allows resource planning across all project management systems in SAP Portfolio and Project Management. Resource information, such as the availability of employees or their skills, can also be integrated in SAP Portfolio and Project Management for resource planning from personnel administration. In addition, integrating SAP Portfolio and Project Management with financial systems enables a standardized evaluation of the costs, revenue, budgets, or commitments of your portfolio items. ● Resource Planning Along with the strategic planning of capacity requirements, you can also implement detailed resource planning for your portfolio items in SAP Portfolio and Project Management. This means that resource information from integrated Project Management systems and human resources can be combined uniformly in SAP Portfolio and Project Management. Fast entry screens allow resource managers tabular access to the resources and projects assigned to them. ● Reporting and Analysis Functions SAP Portfolio and Project Management uses dashboards to display basic data of portfolio items in an overview. Traffic light functions alert you to exceptions and allow you to examine these exceptions in detail. Reporting cockpits allow tabular and graphical evaluations of the critical success factors of your portfolio items. For more detailed analyses, SAP Portfolio and Project Management provides predefined business content for use in SAP NetWeaver Business Intelligence (SAP NetWeaver BI). You can use queries directly in SAP Portfolio and Project Management to perform cross-portfolio analyses for the strategic alignment of portfolio items, or for the financial or capacity situation of your portfolio. Lesson: Describing PPM © Copyright. All rights reserved. 27

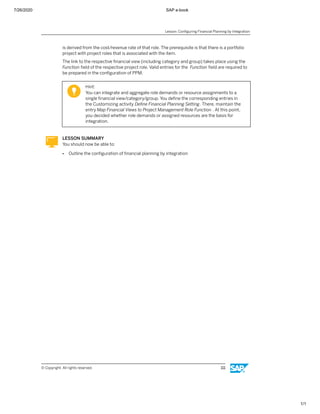

36.
7/26/2020 SAP e-book 1/1 Roles
in SAP PPM Table 1: Roles in SAP Portfolio and Project Management (SAP PPM) The table shows the roles and tasks in SAP PPM: Portfolio Administrator Item Manager Portfolio Manager Resources Manager Creates portfolios Monitors portfolio items Monitors dash- boards Plans strategic capaci- ty requirements Creates portfolio struc- tures Creates and edits portfolio items Analyzes portfolio Distributes resources Creates resource pools Uploads project da- ta Implements strate- gic planning Monitors capacity sit- uations Configures dashboards and graphics Changes item sta- tuses Creates reviews Creates portfolio items SAP PPM can be used by various groups of people with the relevant roles. The table, Roles in SAP Portfolio and Project Management (SAP PPM), shows the various groups of people and their typical tasks in SAP PPM. The individual tasks and the related business processes are explained in detail later in this course. Portfolio Structure Figure 23: Structure Objects in PPM The figure, Structure Objects in PPM, shows different structure objects in PPM. The uppermost structure object is the portfolio. Authorizations that you assign to users at the level of a portfolio are inherited to all lower-level structure objects but can also be changed there if necessary. You can define several portfolios in PPM to set up completely separate areas of responsibility. Many PPM functions, such as reviews or reporting based on Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 28
37.

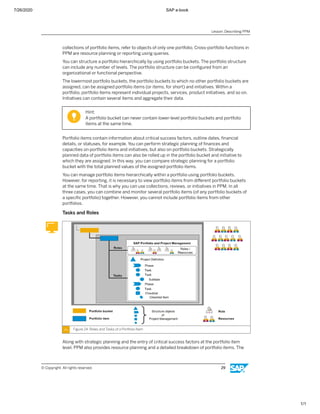

7/26/2020 SAP e-book 1/1 collections
of portfolio items, refer to objects of only one portfolio. Cross-portfolio functions in PPM are resource planning or reporting using queries. You can structure a portfolio hierarchically by using portfolio buckets. The portfolio structure can include any number of levels. The portfolio structure can be configured from an organizational or functional perspective. The lowermost portfolio buckets, the portfolio buckets to which no other portfolio buckets are assigned, can be assigned portfolio items (or items, for short) and initiatives. Within a portfolio, portfolio items represent individual projects, services, product initiatives, and so on. Initiatives can contain several items and aggregate their data. Hint: A portfolio bucket can never contain lower-level portfolio buckets and portfolio items at the same time. Portfolio items contain information about critical success factors, outline dates, financial details, or statuses, for example. You can perform strategic planning of finances and capacities on portfolio items and initiatives, but also on portfolio buckets. Strategically planned data of portfolio items can also be rolled up in the portfolio bucket and initiative to which they are assigned. In this way, you can compare strategic planning for a portfolio bucket with the total planned values of the assigned portfolio items. You can manage portfolio items hierarchically within a portfolio using portfolio buckets. However, for reporting, it is necessary to view portfolio items from different portfolio buckets at the same time. That is why you can use collections, reviews, or initiatives in PPM. In all three cases, you can combine and monitor several portfolio items (of any portfolio buckets of a specific portfolio) together. However, you cannot include portfolio items from other portfolios. Tasks and Roles Figure 24: Roles and Tasks of a Portfolio Item Along with strategic planning and the entry of critical success factors at the portfolio item level, PPM also provides resource planning and a detailed breakdown of portfolio items. The Lesson: Describing PPM © Copyright. All rights reserved. 29
38.
7/26/2020 SAP e-book 1/1 figure,
Roles and Tasks of a Portfolio Item, shows the relationship between portfolio items and project management functions. If you want to plan resources for a portfolio item or if you require a subdivision, you can link the portfolio item with a Project Management project. The associated project can be created automatically while saving the item. Optionally, you can create the portfolio item and the Project Management project independently of each other and link them together at a later time. The Project Management project can be structured using phases and tasks. Tasks can be subdivided into subtasks. In turn, you can assign subtasks to the subtasks. You can create entire task hierarchies in Project Management. Other structure objects in Project Management include the project definition that functions as a framework for the entire project, as well as checklists and checklist items. For resource planning with Project Management, you require a project definition. With reference to the project definition, you can then define roles. Roles are formal descriptions of the resources required for a project. A role definition contains tasks for the required time period, resource requirements, and any qualification requirements, which the resources fulfill. A role can be filled with one or more resources at a later stage. In this case, a resource can be an internal employee or even an external partner. Technically, these resources are depicted as business partners in PPM or Project Management. They are represented as business partners for which the availability or qualifications can be managed centrally in PPM. If you linked a portfolio item with Project Management, you can choose Tasks to navigate from the portfolio item to the associated project. Choose Roles to go to the resource view of the associated project. The distribution of resources and evaluation of the availability of these resources is usually performed in PPM across all projects. For this purpose, you can use the Resource Management tab in the top-level navigation of PPM. Resource planning data for a Project Management project, for example, the resource requirements or distribution of resources, can be integrated with the strategic capacity planning of the assigned portfolio item. This means that you can compare your strategic capacity planning with the values of your detailed resource planning at the portfolio item level, or even at the level of the parent portfolio bucket. LESSON SUMMARY You should now be able to: ● Describe SAP PPM ● Navigate in SAP PPM Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 30
39.

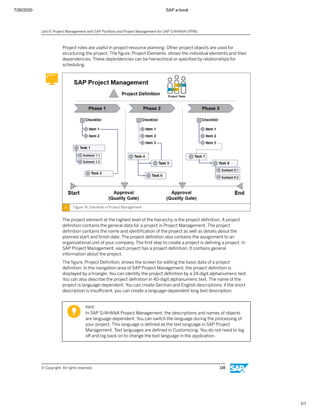

7/26/2020 SAP e-book 1/1 Unit

1 Lesson 4 Describing Integration Scenarios for PPM LESSON OVERVIEW This lesson explores the possibilities of integrating various structure objects of SAP Portfolio and Project Management with external applications. Business Example You need an overview of possible integration scenarios of SAP Portfolio and Project Management. For this reason, you require the following knowledge: ● An understanding of the integration options of SAP Portfolio and Project Management. LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline the basic integration of PPM ● Outline specific integration scenarios of PPM Integration of PPM Figure 25: Integration Possibilities The figure, Integration Possibilities, illustrates how many companies use other project management systems instead of (or in addition to) Project Management in various departments or for various project categories. These include Microsoft Project, Project © Copyright. All rights reserved. 31
40.

7/26/2020 SAP e-book 1/1 System,
or any standalone external project management systems. PPM allows you to integrate data from projects of these project management systems. Project Management is a tool that can be used for the operational management of projects within PPM. Along with project structuring and the management of resources, Project Management also provides functions such as time scheduling or document management. Based on the planned work for roles or tasks, you can also calculate costs or revenues in Project Management and transfer them to internal orders or work breakdown structures. The implementation phase of projects in Project Management is supported by the status management and special approval processes for phases and confirmations. By default, you can link Microsoft Project, Project System, and Project Management with PPM. Data from these project management systems can be uploaded to PPM to be evaluated and compared together in PPM, or to be used for central resource management. The data from projects of these project management systems can be used to adjust data in portfolio items, and also to create task hierarchies and roles in the assigned Project Management projects. Another PPM interface allows you to integrate the resource data required for the central resource management across all project management systems from SAP Human Capital Management (SAP HCM) systems. Based on personnel data in SAP HCM, you can automatically create and update business partners, their qualifications, and their availability in PPM. Along with the structure, scheduling, and resource data, it is also possible to evaluate financial details of linked projects in PPM to obtain an overall picture. You can make informed decisions about the further processing of these items. For this purpose, you can also upload costs, revenues, budgets, and commitments of these projects from accounting (subsequently referred to as FI/CO) to PPM. You can compare them with the strategic financial planning of items and buckets. These costs also include the costs for the work carried out by the respective resources. To enter this work and to calculate the corresponding costs, you can use the Cross-Application Time Sheet (CATS). For a better understanding of how PPM or Project Management, external project management systems, FI/CO, and CATS work together, see the figures, Integration Scenario 1, Integration Scenario 2, and Integration Scenario 3. For the sake of simplicity, integration with HCM is not mentioned. Hint: The following integration scenarios represent only selected examples for integrated business processes. You can also implement various other integration scenarios and processes in PPM. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 32
41.

7/26/2020 SAP e-book 1/1 Integration

with SAP Financials Figure 26: Integration Scenario 1 Many customers use Project Management directly for the operational management of their projects. Therefore, it is not necessary to set up an integration with an external project management system. Integration with FI/CO is used to display financial details in PPM. The sample scenario displayed in the figure, Integration Scenarios 1, begins with the creation of a portfolio item. The portfolio manager or item manager creates a portfolio item, enters critical success factors, and executes an initial forecast of the required capacities and financial resources. In a review, decision-makers compare these data with the data of other portfolio items and make a decision regarding the further processing of the portfolio item. Parallel to this, a project is created in Project Management and linked to the portfolio item. This can be performed automatically or manually when the portfolio item is created at a later stage, for example, after the portfolio item is first approved. The project lead defines the project roles required for their project, and the relevant resource manager then provides these roles with suitable resources. The resource requirements and staffing can be integrated into the strategic capacity planning of the portfolio item and compared with the projected capacity requirements. Parallel to the associated project, you can create cost collectors in the FI/CO system. You can use these collectors for a detailed cost planning, budgeting (if required), and collection of the actual costs of the project. Cost collectors can be one or more internal orders or a Project System work breakdown structure that allows multilevel controlling of the project. Cost collectors can be created automatically from Project Management. You can also manually create cost collectors in the FI/CO system and then link them with the Project Management project (account assignment). Data from Project Management can then be transferred automatically to the cost collectors and used for cost estimates. By integrating the FI/CO system with PPM, the planning data of the cost collector can also be transferred to the corresponding portfolio item, and compared with the projected financial details. After the approval of the portfolio item, the associated project is released. The resources assigned to the project can confirm their working hours using CATS. The resources can automatically import default values from Project Management to the CATS worklist. The data Lesson: Describing Integration Scenarios for PPM © Copyright. All rights reserved. 33
42.
7/26/2020 SAP e-book 1/1 entered
in CATS can then be transferred to Project Management and FI/CO. This results in actual costs on the cost collectors for the work carried out. In turn, the actual work and actual costs of the cost collector can be transferred to the portfolio item and monitored in PPM. Integration with Project System Figure 27: Integration Scenario 2 Operational project management is performed with Project System instead of Project Management. With the integration of FI/CO, the cost, revenue, budget, and commitment data from Project System is transferred to PPM. The sample scenario outlined in the figure, Integration Scenarios 2, also begins with the creation, strategic planning, and a first review (if applicable) of a portfolio item. In parallel, a project is created in Project System. You can do this manually, or you can create a project in Project System from the portfolio item. The project is used in Project System for a detailed structure, scheduling, and cost planning. You can synchronize attributes and statuses of the Project System project with the item and item decision points. The synchronization can be bidirectional. Financial planning data of Project System projects are also transferred to PPM, and are compared to the strategic financial data. If necessary, the budgeting and execution of the project is performed in Project System once the portfolio item has been approved in PPM. For example, you can use the time sheet to enter time data and to post actual costs to the project. By uploading project data to portfolio item, you can monitor the dates and financial details, and therefore, the project progress in PPM. Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 34
43.

7/26/2020 SAP e-book 1/1 Integration

with Microsoft Project Figure 28: Integration Scenario 3 The figure, Integration Scenario 3, displays a scenario in which Microsoft Project is used for the operational management of a project. The cost and revenue of the project are managed in parallel in FI/CO. In PPM, you can combine and monitor the project data from Microsoft Project and the financial details from FI/CO. In addition, you can use PPM for the central administration of resources. This sample scenario also begins with the creation, strategic planning, and, if applicable, a first review of a portfolio item. In PPM, a project definition is automatically created as a technical basis for the integration of structure, scheduling, and resource data from Microsoft Project. The structuring, scheduling, and determination of the required resources of the project are performed in Microsoft Project. When you upload project data to PPM or Project Management, this creates the corresponding project structure elements and roles. The resource manager in PPM can then staff these roles with suitable resources. The integration of data with the strategic capacity planning allows an aggregated evaluation at the portfolio item level and at the level of portfolio buckets. Cost and revenue planning, any budgeting, the posting of actual cost, and revenue are performed in a cost collector (for example, an internal order in FI/CO). The cost collector is linked to the portfolio item in PPM. The financial details can then be transferred to the portfolio item and integrated into the strategic financial planning. At the portfolio item level in PPM, the project data from Microsoft Project as well as the corresponding financial details from FI/CO can be evaluated and monitored together. LESSON SUMMARY You should now be able to: ● Outline the basic integration of PPM ● Outline specific integration scenarios of PPM Lesson: Describing Integration Scenarios for PPM © Copyright. All rights reserved. 35
44.

7/26/2020 SAP e-book 1/1 Unit

1 Lesson 5 Introduction to PPM LESSON OBJECTIVES After completing this lesson, you will be able to: ● Describing PPM Describing PPM Successful companies distinguish themselves from others by aligning their entire portfolio with the strategic goals of the company. In practice, this applies to the introduction of a new product or to companies in which project-based business processes play a central role. For finance and resource-intensive projects, it is important to recognize profitable projects and to monitor and control these accordingly. PPM is a tool that supports companies in their strategic and operative portfolio management. PPM enables you to manage several portfolios such as product innovations, service industries, and IT initiatives. PPM can combine data from various project management, human resources management and financial systems. This enables new cross-functional business processes and the ability to have an extensive overview of all business processes. Strategic and Operative Portfolio and Project Management PPM helps you to overcome the challenges of strategic and operative portfolio management achieving the following objectives: ● Align your portfolio with your corporate goals With PPM, your portfolio items and initiatives are regularly assessed according to their exact strategic value, and your commercial success is proven and accelerated. ● Maximize the value of your portfolio You can select the most promising portfolio items and guarantee steady success. At the same time, you can ensure a balanced portfolio with acceptable risks, dynamic business targets, and various investment types. ● Create more transparency and make informed decisions PPM combines data from SAP and external systems, so that underachieving or overlapping projects and capacity bottlenecks can be quickly recognized and adjusted. ● Use your resources more effectively PPM helps you track and prioritize resource requests from various project management systems, and reconcile the availability specified in the HCM and financial systems. In this way, you can find suitable resources (internal or external), lower costs, and benefit from the optimum personnel assignment of your projects. ● Control your portfolio more efficiently © Copyright. All rights reserved. 36
45.

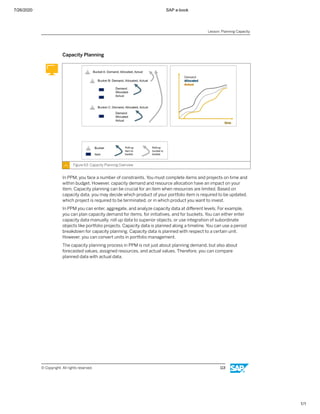

7/26/2020 SAP e-book 1/1 Using
automated role-specific workflows, you can optimize approval procedures, resource allocations, or successive evaluations. A strict workflow-based process control enables you to implement investment guidelines throughout the company for product developments or IT projects. ● Reduce your total cost of ownership PPM can be integrated with many back-end systems from SAP. In this way, you can continue to optimize existing IT systems and available skills. Business Functions in Portfolio Management PPM offers many functions that support you in managing your portfolios. Some of the key functions are as follows: ● Portfolio definition You can define several portfolios and subdivide portfolios hierarchically according to your own requirements by using portfolio buckets. This means you can monitor your portfolio items such as projects or product initiatives in an overview. The use of collections, reviews, or initiatives enables you to manage portfolio items of different portfolio buckets of a portfolio at the same time if necessary. ● Questionnaires and scoring model You can define your own questionnaires to determine critical success factors for your portfolio items and initiatives. Using your own scoring model, critical success factors can be automatically derived from the portfolio item data and then used for prioritizing. These functions allow you to align your portfolios with your corporate goals. ● Financial and capacity planning For the purpose of forecasting or for strategic planning, you can enter financial and capacity data at the level of portfolio buckets, individual portfolio items, or initiatives. You can then compare these data with detailed planning values or actual data, which can be combined in PPM from S/4HANA PPM projects or PS projects. ● Control Reviews allow you to make decisions about portfolio items in PPM; for example, you can decide which IT projects should be implemented or which projects can be canceled. If necessary, you can also use simulations and what-if analyses to discuss alternative scenarios for portfolio items. Using individual decision points and versions, you can control and trace the flow of your portfolio items. Using workflows, you can also ensure that changes are communicated and therefore, your company’s guidelines are followed. ● Integration You can link various project management systems such as Project System, Project Management, or Microsoft Project with PPM to uniformly monitor structural, date-related, or resource information. The unification of resource data also allows resource planning across all project management systems in PPM. Resource information, such as the availability of employees or their skills, can also be integrated in PPM for resource planning from personnel administration. In addition, integrating PPM with financial systems enables a standardized evaluation of the costs, revenue, budgets, or commitments of your portfolio items. ● Resource planning Lesson: Introduction to PPM © Copyright. All rights reserved. 37
46.

7/26/2020 SAP e-book 1/1 Along

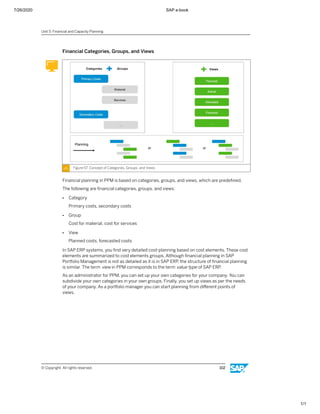

with the strategic planning of capacity requirements, you can also implement detailed resource planning for your portfolio items in PPM. This means that resource information from integrated Project Management systems and human resources can be combined uniformly in PPM. Fast entry screens allow resource managers tabular access to the resources and projects assigned to them. ● Reporting and analysis functions PPM uses dashboards to display basic data of portfolio items in an overview. Traffic light functions alert you to exceptions and allow you to examine these exceptions in detail. Reporting cockpits allow tabular and graphical evaluations of the critical success factors of your portfolio items. You can use queries directly in PPM to perform cross-portfolio analyses for the strategic alignment of portfolio items, or for the financial or capacity situation of your portfolio. Roles in PPM The following table shows the typical roles and tasks in PPM: Portfolio Administrator Item Manager Portfolio Manager Resources Manager Creates portfolios Monitors portfolios Monitors dashboards Plans strategic capacity requirements Creates portfolio structures Creates and edits portfolio items Analyzes portfolio Distributes resources Creates resource pools Uploads project data Implements strategic planning Monitors capacity situations Configures dashboards and graphics Changes item status Creates reviews Creates portfolio items PPM can be used by various groups of people with the relevant roles. The table, Roles in PPM, shows the various groups of people and their typical tasks in PPM. The individual tasks and the related business processes are explained in detail later on in this course. LESSON SUMMARY You should now be able to: ● Describing PPM Unit 1: Introduction to SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 38
47.

7/26/2020 SAP e-book 1/1 Unit

1 Learning Assessment 1. What must you do to achieve a standardized evaluation of the costs, revenue, budgets, or commitments of your portfolio items? Choose the correct answer. X A Combine actual data in SAP Portfolio and Project Management (PPM) from finance and project management systems. X B Use simulations and what-if analyses. X C Integrate PPM with financial systems. X D Integrate PPM with personnel administration. 2. A portfolio bucket can contain lower-level portfolio buckets and portfolio items at the same time. Determine whether this statement is true or false. X True X False 3. By default, you cannot link Microsoft Project, Project System, and Project Management with PPM. Determine whether this statement is true or false. X True X False 4. When you upload project data to PPM or Project Management, you have to manually create the corresponding work breakdown structure elements and roles. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 39
48.

7/26/2020 SAP e-book 1/1 Unit
1 Learning Assessment - Answers 1. What must you do to achieve a standardized evaluation of the costs, revenue, budgets, or commitments of your portfolio items? Choose the correct answer. X A Combine actual data in SAP Portfolio and Project Management (PPM) from finance and project management systems. X B Use simulations and what-if analyses. X C Integrate PPM with financial systems. X D Integrate PPM with personnel administration. Correct. Integrating PPM with financial systems enables a standardized evaluation of the costs, revenue, budgets, or commitments of your portfolio items. 2. A portfolio bucket can contain lower-level portfolio buckets and portfolio items at the same time. Determine whether this statement is true or false. X True X False Correct. A portfolio bucket can never contain lower-level portfolio buckets and portfolio items at the same time. 3. By default, you cannot link Microsoft Project, Project System, and Project Management with PPM. Determine whether this statement is true or false. X True X False Correct. By default, you can link Microsoft Project, Project System, and Project Management with PPM. © Copyright. All rights reserved. 40
49.

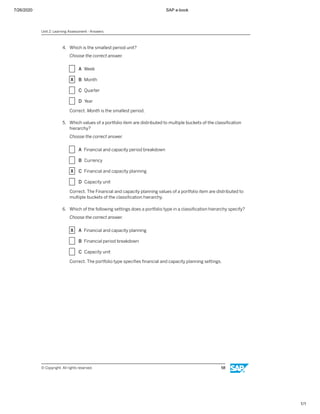

7/26/2020 SAP e-book 1/1 4.
When you upload project data to PPM or Project Management, you have to manually create the corresponding work breakdown structure elements and roles. Determine whether this statement is true or false. X True X False Correct. When you upload project data to PPM or Project Management, it creates the corresponding project structure elements and roles. Unit 1: Learning Assessment - Answers © Copyright. All rights reserved. 41
50.
7/26/2020 SAP e-book 1/1 UNIT

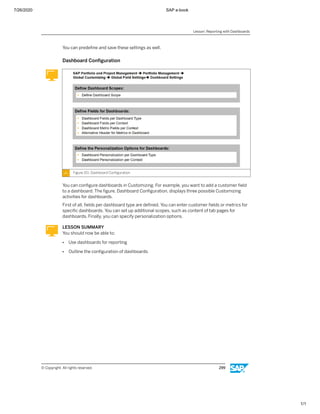

2 Portfolio Definition and Buckets Lesson 1 Managing the Portfolio Definition 43 Lesson 2 Managing Portfolio Buckets 48 Lesson 3 Managing Classification Hierarchies 52 UNIT OBJECTIVES ● Create a portfolio type ● Create a portfolio definition ● Create portfolio buckets ● Check the configuration for portfolio buckets ● Create a classification hierarchy ● Check the configuration of classification hierarchies © Copyright. All rights reserved. 42
51.
7/26/2020 SAP e-book 1/1 Unit

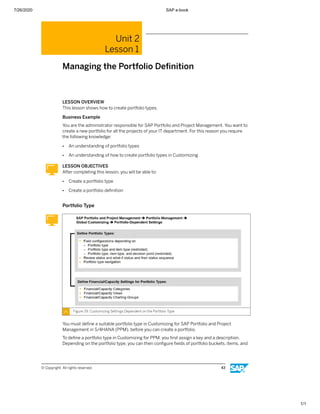

2 Lesson 1 Managing the Portfolio Definition LESSON OVERVIEW This lesson shows how to create portfolio types. Business Example You are the administrator responsible for SAP Portfolio and Project Management. You want to create a new portfolio for all the projects of your IT department. For this reason you require the following knowledge: ● An understanding of portfolio types ● An understanding of how to create portfolio types in Customizing LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create a portfolio type ● Create a portfolio definition Portfolio Type Figure 29: Customizing Settings Dependent on the Portfolio Type You must define a suitable portfolio type in Customizing for SAP Portfolio and Project Management in S/4HANA (PPM), before you can create a portfolio. To define a portfolio type in Customizing for PPM, you first assign a key and a description. Depending on the portfolio type, you can then configure fields of portfolio buckets, items, and © Copyright. All rights reserved. 43
52.

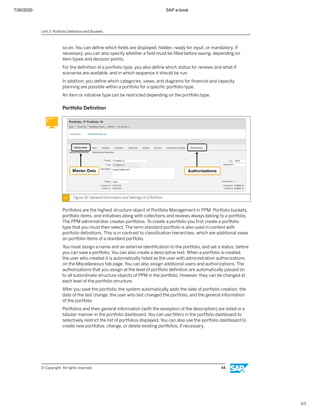

7/26/2020 SAP e-book 1/1 so
on. You can define which fields are displayed, hidden, ready for input, or mandatory. If necessary, you can also specify whether a field must be filled before saving, depending on item types and decision points. For the definition of a portfolio type, you also define which status for reviews and what-if scenarios are available, and in which sequence it should be run. In addition, you define which categories, views, and diagrams for financial and capacity planning are possible within a portfolio for a specific portfolio type. An item or initiative type can be restricted depending on the portfolio type. Portfolio Definition Figure 30: General Information and Settings of a Portfolio Portfolios are the highest structure object of Portfolio Management in PPM. Portfolio buckets, portfolio items, and initiatives along with collections and reviews always belong to a portfolio. The PPM administrator creates portfolios. To create a portfolio you first create a portfolio type that you must then select. The term standard portfolio is also used in context with portfolio definitions. This is in contrast to classification hierarchies, which are additional views on portfolio items of a standard portfolio. You must assign a name and an external identification to the portfolio, and set a status, before you can save a portfolio. You can also create a descriptive text. When a portfolio is created, the user who created it is automatically listed as the user with administration authorizations on the Miscellaneous tab page. You can also assign additional users and authorizations. The authorizations that you assign at the level of portfolio definition are automatically passed on to all subordinate structure objects of PPM in the portfolio. However, they can be changed at each level of the portfolio structure. After you save the portfolio, the system automatically adds the date of portfolio creation, the date of the last change, the user who last changed the portfolio, and the general information of the portfolio. Portfolios and their general information (with the exception of the description) are listed in a tabular manner in the portfolio dashboard. You can use filters in the portfolio dashboard to selectively restrict the list of portfolios displayed. You can also use the portfolio dashboard to create new portfolios, change, or delete existing portfolios, if necessary. Unit 2: Portfolio Definition and Buckets © Copyright. All rights reserved. 44
53.

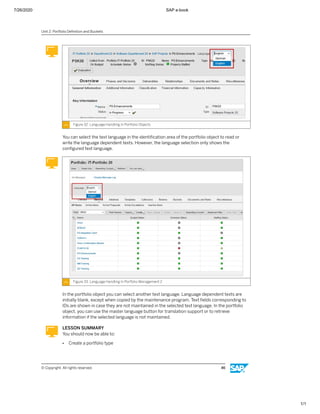

7/26/2020 SAP e-book 1/1 Language
Handling in Portfolio Management A portfolio master language is selected from the Customizing text languages for PPM. You can choose a language from all the available languages in the SAP system. Language handling has the following features: ● You use Customizing to specify text languages. ● You must set one language as default. ● The default language is the text language when the logon language of the user is not available in Customizing. ● When only one language is in the customizing table, portfolios become language independent and the functionality of the master language is hidden. You must select the master language during portfolio creation and it is valid for the language dependent fields and long texts. Figure 31: Language Handling In Portfolio Management Language Handling in Portfolio Objects When you create a new object in a portfolio, the system automatically sets the text language in the following ways: ● The master language of the portfolio. ● The logon language, if no master language is defined. ● The default language, if the logon language is not a defined text language. After you create a new item, you can select the text language for text maintenance. Lesson: Managing the Portfolio Definition © Copyright. All rights reserved. 45
54.
7/26/2020 SAP e-book 1/1 Figure
32: Language Handling In Portfolio Objects You can select the text language in the identification area of the portfolio object to read or write the language dependent texts. However, the language selection only shows the configured text language. Figure 33: Language Handling In Portfolio Management 2 In the portfolio object you can select another text language. Language dependent texts are initially blank, except when copied by the maintenance program. Text fields corresponding to IDs are shown in case they are not maintained in the selected text language. In the portfolio object, you can use the master language button for translation support or to retrieve information if the selected language is not maintained. LESSON SUMMARY You should now be able to: ● Create a portfolio type Unit 2: Portfolio Definition and Buckets © Copyright. All rights reserved. 46
55.
7/26/2020 SAP e-book 1/1 ●
Create a portfolio definition Lesson: Managing the Portfolio Definition © Copyright. All rights reserved. 47
56.
7/26/2020 SAP e-book 1/1 Unit

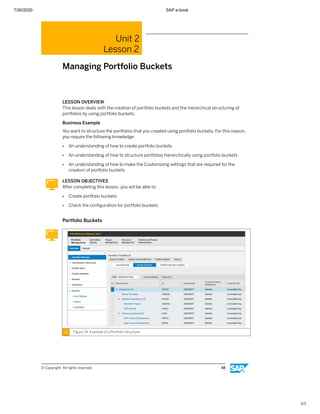

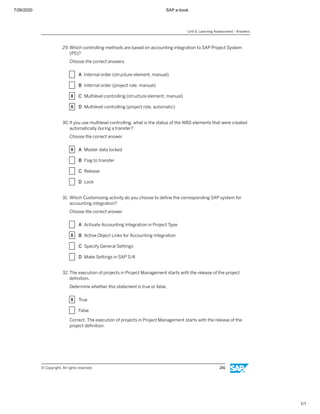

2 Lesson 2 Managing Portfolio Buckets LESSON OVERVIEW This lesson deals with the creation of portfolio buckets and the hierarchical structuring of portfolios by using portfolio buckets. Business Example You want to structure the portfolios that you created using portfolio buckets. For this reason, you require the following knowledge: ● An understanding of how to create portfolio buckets ● An understanding of how to structure portfolios hierarchically using portfolio buckets ● An understanding of how to make the Customizing settings that are required for the creation of portfolio buckets LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create portfolio buckets ● Check the configuration for portfolio buckets Portfolio Buckets Figure 34: Example of a Portfolio Structure © Copyright. All rights reserved. 48
57.
7/26/2020 SAP e-book 1/1 Using

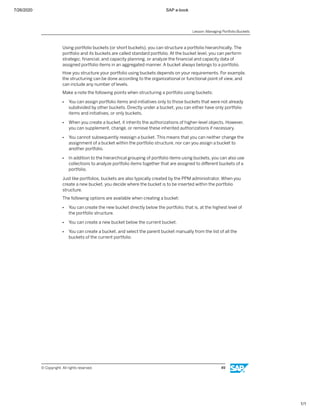

portfolio buckets (or short buckets), you can structure a portfolio hierarchically. The portfolio and its buckets are called standard portfolio. At the bucket level, you can perform strategic, financial, and capacity planning, or analyze the financial and capacity data of assigned portfolio items in an aggregated manner. A bucket always belongs to a portfolio. How you structure your portfolio using buckets depends on your requirements. For example, the structuring can be done according to the organizational or functional point of view, and can include any number of levels. Make a note the following points when structuring a portfolio using buckets: ● You can assign portfolio items and initiatives only to those buckets that were not already subdivided by other buckets. Directly under a bucket, you can either have only portfolio items and initiatives, or only buckets. ● When you create a bucket, it inherits the authorizations of higher-level objects. However, you can supplement, change, or remove these inherited authorizations if necessary. ● You cannot subsequently reassign a bucket. This means that you can neither change the assignment of a bucket within the portfolio structure, nor can you assign a bucket to another portfolio. ● In addition to the hierarchical grouping of portfolio items using buckets, you can also use collections to analyze portfolio items together that are assigned to different buckets of a portfolio. Just like portfolios, buckets are also typically created by the PPM administrator. When you create a new bucket, you decide where the bucket is to be inserted within the portfolio structure. The following options are available when creating a bucket: ● You can create the new bucket directly below the portfolio, that is, at the highest level of the portfolio structure. ● You can create a new bucket below the current bucket. ● You can create a bucket, and select the parent bucket manually from the list of all the buckets of the current portfolio. Lesson: Managing Portfolio Buckets © Copyright. All rights reserved. 49
58.
7/26/2020 SAP e-book 1/1 Bucket
Details Figure 35: Tab Pages and Fields of Portfolio Buckets The data that you enter in a bucket is spread across the following different tab pages: General Information tab page On the General Information tab page, you must enter a name, the external identification, and the status. Administrative data, such as the creation date or last change date, is updated by the system when you save the changes. The higher-level object in the portfolio structure hierarchy, the number of assigned portfolio items and reviews are also automatically determined by the system. You can also enter a description for a bucket. Financial and Capacity Information tab page On the Financial and Capacity Information tab page, all fields are mandatory fields. You use these fields to control the time period for which financial and capacity planning is possible for a bucket. You can also specify which currency, which capacity unit, and which period breakdown is used for financial and capacity planning by default. Authorizations tab page On the Authorizations tab page, you can assign new authorizations or change inherited authorizations. Notes tab page When you enter notes using the Notes tab page of a bucket, notes are automatically supplemented with information about who entered them and the entry time and date. Field Service Configuration tab page On the Field Service Configuration tab page, you can define which questionnaires or scoring models are to be available with which fields of the assigned portfolio items. You define in Customizing for PPM the fields that are to be available here for configuration. In addition to the data listed in the figure, you can also plan financial and capacity data for a bucket. Unit 2: Portfolio Definition and Buckets © Copyright. All rights reserved. 50
59.
7/26/2020 SAP e-book 1/1 Configuration
for Portfolio Buckets Figure 36: Customizing of Portfolio Buckets The figure, Customizing of Portfolio Buckets, shows the customizing settings that are required for portfolio buckets. In the customizing activity Define Capacity Units, you define which time units are available as units for capacity planning when you create portfolio buckets. You determine a subset of the total time units (such as hours or days) defined in the PPM core system. If necessary, you can also define additional capacity units (such as consultant days) that are not in the standard system. To do so, first use the transaction CUNI to create a new time unit (consultant day = 28,800 seconds = 8 hours), and then select this as an additional capacity unit in Customizing for PPM. Similarly, in the customizing activity Define Currency Units, you select a subset of the total currencies defined in the PPM core system. Only the currencies selected here can be used later when you create a bucket, or within financial planning for buckets and portfolio items. In the customizing activity Define Period Types , you finally define which period units are to be available as the period breakdown for financial or capacity planning. The smallest period unit is a month. Based on this period unit, you can define other period types as integral multiples of months, such as quarterly (equals 3 months) or annually (equals 12 months). LESSON SUMMARY You should now be able to: ● Create portfolio buckets ● Check the configuration for portfolio buckets Lesson: Managing Portfolio Buckets © Copyright. All rights reserved. 51
60.
7/26/2020 SAP e-book 1/1 Unit

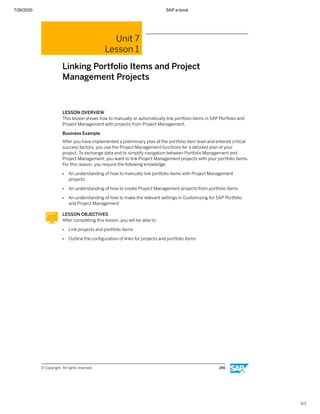

2 Lesson 3 Managing Classification Hierarchies LESSON OVERVIEW The lesson describes the use and configuration of classification hierarchies in SAP Portfolio and Project Management. Business Example In your company, you use a single standard portfolio that corresponds to the product hierarchy. However, you also want to analyze your portfolio from a market perspective, and from the organizational point of view. For this reason, you require the following knowledge: ● An understanding of how to create classification hierarchies ● An understanding of how to assign portfolio items to classification hierarchies LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create a classification hierarchy ● Check the configuration of classification hierarchies Classification Hierarchy Figure 37: The Concept of Classification Hierarchies Classification hierarchies are used as additional hierarchies to standard portfolio structures. You can create classification hierarchies to map additional views to your standard portfolio. The standard portfolio hierarchy corresponds to the organizational structure of a company. Portfolio items and initiatives are assigned to buckets of a standard portfolio hierarchy. You © Copyright. All rights reserved. 52
61.
7/26/2020 SAP e-book 1/1 can
analyze your portfolio with respect to a standard portfolio hierarchy. You may think about additional hierarchies like a market-specific hierarchy or a product-specific hierarchy. To build such hierarchies, you can use classification hierarchies. The figure demonstrates a portfolio item that is assigned to a single bucket of a standard portfolio, and split into multiple buckets of a classification hierarchy. You may even create more than one alternative classification hierarchy. Financial planning values and capacity planning of a portfolio item are distributed into multiple buckets of the classification hierarchy in the same way as the item is split into the multiple buckets. Portfolio – Specific Classification Hierarchies Figure 38: Portfolio – Specific Classification Hierarchies You can create classification hierarchies as portfolio-specific hierarchies or as cross-portfolio hierarchies. The figure demonstrates two standard portfolios with two portfolio-specific classification hierarchies. You create classification hierarchies in a similar way to how you create standard portfolios. As a portfolio administrator, you use the administrator workset for portfolios. You can create a cross-portfolio classification hierarchy. Alternatively, by selecting a portfolio in the dashboard, you can create a portfolio-specific classification hierarchy. You must select a portfolio type and enter master data the same way that you do them for standard portfolios. For example, you can enter a description and authorizations. Portfolio Elements and Classification Hierarchies You can assign existing portfolio items to multiple classification hierarchies. This procedure is usually performed by a portfolio item manager. To do so, open an item and navigate to Classification. This is a subordinate tab to the Overview tab. In this tab, you can select a single classification hierarchy and split the item into multiple buckets. You may specify a factor for distributing financial and capacity planning data of the item to multiple buckets. You can also assign the initiatives of a standard portfolio to the buckets of a classification hierarchy. Planning Classification Hierarchies Financial and capacity planning for the buckets of a classification hierarchy works the same way as financial and capacity planning for the buckets of a standard portfolio. For example, Lesson: Managing Classification Hierarchies © Copyright. All rights reserved. 53
62.

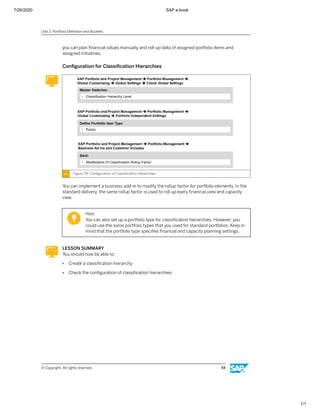

7/26/2020 SAP e-book 1/1 you
can plan financial values manually and roll-up data of assigned portfolio items and assigned initiatives. Configuration for Classification Hierarchies Figure 39: Configuration of Classification Hierarchies You can implement a business add-in to modify the rollup factor for portfolio elements. In the standard delivery, the same rollup factor is used to roll up every financial view and capacity view. Hint: You can also set up a portfolio type for classification hierarchies. However, you could use the same portfolio types that you used for standard portfolios. Keep in mind that the portfolio type specifies financial and capacity planning settings. LESSON SUMMARY You should now be able to: ● Create a classification hierarchy ● Check the configuration of classification hierarchies Unit 2: Portfolio Definition and Buckets © Copyright. All rights reserved. 54
63.
7/26/2020 SAP e-book 1/1 Unit

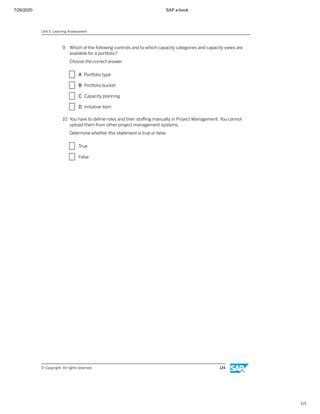

2 Learning Assessment 1. When you create a portfolio, it is mandatory to select a portfolio type. Determine whether this statement is true or false. X True X False 2. When a portfolio is created, the user who created it is automatically listed as the user with administration authorizations. Determine whether this statement is true or false. X True X False 3. When you create a bucket, it inherits the authorizations of higher-level objects, which cannot be changed or removed. Determine whether this statement is true or false. X True X False 4. Which is the smallest period unit? Choose the correct answer. X A Week X B Month X C Quarter X D Year © Copyright. All rights reserved. 55
64.
7/26/2020 SAP e-book 1/1 5.
Which values of a portfolio item are distributed to multiple buckets of the classification hierarchy? Choose the correct answer. X A Financial and capacity period breakdown X B Currency X C Financial and capacity planning X D Capacity unit 6. Which of the following settings does a portfolio type in a classification hierarchy specify? Choose the correct answer. X A Financial and capacity planning X B Financial period breakdown X C Capacity unit Unit 2: Learning Assessment © Copyright. All rights reserved. 56
65.
7/26/2020 SAP e-book 1/1 Unit
2 Learning Assessment - Answers 1. When you create a portfolio, it is mandatory to select a portfolio type. Determine whether this statement is true or false. X True X False Correct. When you create a portfolio, it is mandatory to select a portfolio type. 2. When a portfolio is created, the user who created it is automatically listed as the user with administration authorizations. Determine whether this statement is true or false. X True X False Correct. When a portfolio is created, the user who created it is automatically listed as the user with administration authorizations. 3. When you create a bucket, it inherits the authorizations of higher-level objects, which cannot be changed or removed. Determine whether this statement is true or false. X True X False Correct. When you create a bucket, it inherits the authorizations of higher-level objects. However, you can supplement, change, or remove these inherited authorizations if necessary. © Copyright. All rights reserved. 57
66.
7/26/2020 SAP e-book 1/1 4.
Which is the smallest period unit? Choose the correct answer. X A Week X B Month X C Quarter X D Year Correct. Month is the smallest period. 5. Which values of a portfolio item are distributed to multiple buckets of the classification hierarchy? Choose the correct answer. X A Financial and capacity period breakdown X B Currency X C Financial and capacity planning X D Capacity unit Correct. The Financial and capacity planning values of a portfolio item are distributed to multiple buckets of the classification hierarchy. 6. Which of the following settings does a portfolio type in a classification hierarchy specify? Choose the correct answer. X A Financial and capacity planning X B Financial period breakdown X C Capacity unit Correct. The portfolio type specifies financial and capacity planning settings. Unit 2: Learning Assessment - Answers © Copyright. All rights reserved. 58
67.
7/26/2020 SAP e-book 1/1 UNIT
3 Portfolio Items and Initiatives Configuration and Creation Lesson 1 Configuring Portfolio Items 60 Lesson 2 Creating Portfolio Items 63 Lesson 3 Creating Portfolio Initiatives 67 UNIT OBJECTIVES ● Configure a portfolio item type ● Configure a portfolio item category ● Create portfolio items ● Create portfolio items with item templates ● Outline portfolio initiatives ● Create a portfolio initiative ● Outline the synchronization of portfolio initiative master data © Copyright. All rights reserved. 59
68.
7/26/2020 SAP e-book 1/1 Unit

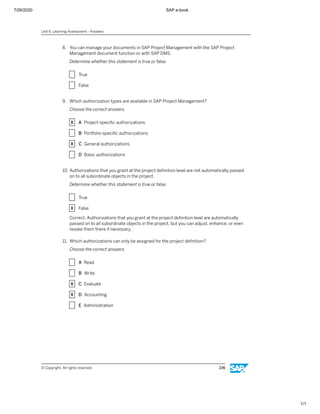

3 Lesson 1 Configuring Portfolio Items LESSON OVERVIEW The lesson discusses the configuration settings for portfolio items. Business Example In your IT department, there are proposals for various software projects. Therefore, you create portfolio items in your portfolio so that you can compare the proposals with each other and then make a decision later about which of these proposals will be actually implemented. In Customizing for SAP Portfolio and Project Management, you want to create a portfolio item type that you can use to create the portfolio items. For this reason, you require the following knowledge: ● An understanding of how to configure portfolio items LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure a portfolio item type ● Configure a portfolio item category Portfolio Item Type Figure 40: Definition of Portfolio Item Types and Dependent Settings To create a new portfolio item type, you must create a key and a text. When you set the Proposal indicator for a portfolio item type, all items for this type are flagged as proposals and © Copyright. All rights reserved. 60
69.
7/26/2020 SAP e-book 1/1 are
displayed on the relevant tab in the item dashboard. Alternatively, items can also be dynamically managed as proposals depending on their status or current decision point. When you create an item, the system may automatically generate a portfolio project at the same time. In the simplest case, the system creates a project definition, which can be used later for resource planning and for uploading project structures of other project management systems. You can define the project type you want to use to create this project definition in the definition of the portfolio item type. If you do not enter a value here, the system uses the project type that is defined in the global settings of SAP Portfolio and Project Management for S/4HANA (PPM). In addition to a project definition, you can define project templates if you want to create a complete portfolio project together with the item. Item type and projects templates are mapped in the customizing activity Map Item Type to Project Templates . In this case, the system uses the project type of the template for the operational project. You can set the NoAutocPro indicator in the definition of the portfolio item type if you do not want a portfolio project, a project definition, or a complete project to be created when you create an item. However, you can remove this indicator when you create an item. If necessary, you can also assign a portfolio project to an item at a later stage. When you define a portfolio item type, define the decision points, the status, and the status sequence in which a decision point can progress. You can also define the possible statuses for an item, and the corresponding sequence in the definition of the portfolio item category. If necessary, you can define whether a field is mandatory or not, depending on the portfolio type and portfolio item type. You can implement this field configuration in the definition of the portfolio types in Customizing for PPM. Portfolio Item Category Figure 41: Definition of Portfolio Item Categories On the Classification tab page of an item, you can specify the location, category, or the priority of the item, which you can use for evaluation purposes at a later stage. The possible field values are defined in Customizing for SAP Portfolio and Project Management . Lesson: Configuring Portfolio Items © Copyright. All rights reserved. 61
70.
7/26/2020 SAP e-book 1/1 In
the customizing activity Define Portfolio Item Categories , you can define possible values for the Category field for items. Depending on the category, you can also define the values for the fields Subcategory, Portfolio Item Group, and Technology Type . To select a technology type in an item, you must always first select the category to which the item belongs. For the Area and Location fields, you can specify the geographical location of an item and use this for later evaluations. You can define areas and locations freely in Customizing for PPM. For example, a location can be an office within a company, a plant, or even a city. Countries, continents, or sales regions are typical areas. However, each location is always uniquely assigned to an area. LESSON SUMMARY You should now be able to: ● Configure a portfolio item type ● Configure a portfolio item category Unit 3: Portfolio Items and Initiatives Configuration and Creation © Copyright. All rights reserved. 62
71.
7/26/2020 SAP e-book 1/1 Unit

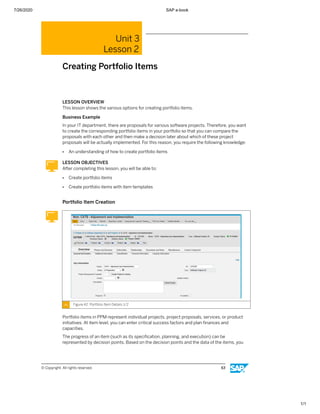

3 Lesson 2 Creating Portfolio Items LESSON OVERVIEW This lesson shows the various options for creating portfolio items. Business Example In your IT department, there are proposals for various software projects. Therefore, you want to create the corresponding portfolio items in your portfolio so that you can compare the proposals with each other and then make a decision later about which of these project proposals will be actually implemented. For this reason, you require the following knowledge: ● An understanding of how to create portfolio items LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create portfolio items ● Create portfolio items with item templates Portfolio Item Creation Figure 42: Portfolio Item Details 1/2 Portfolio items in PPM represent individual projects, project proposals, services, or product initiatives. At item level, you can enter critical success factors and plan finances and capacities. The progress of an item (such as its specification, planning, and execution) can be represented by decision points. Based on the decision points and the data of the items, you © Copyright. All rights reserved. 63
72.
7/26/2020 SAP e-book 1/1 can

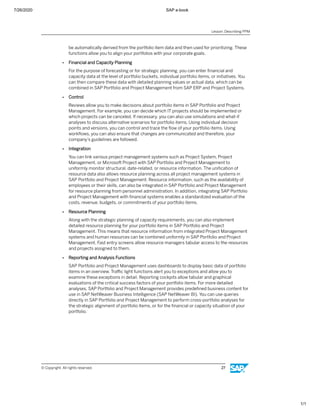

monitor these in PPM, compare them with each other, and make decisions about future progress. The data itself can be entered manually, derived by using questionnaires and scoring models, or determined from allocated projects and controlling objects through integration with Project Management and FI/CO systems. For a detailed structuring and resource planning, items can also use a built-in function for project management in PPM. When you create items, they are allocated to just one portfolio bucket. If necessary, you can change this allocation afterward, that is, you can move items from one bucket to another. However, these buckets must all belong to the same portfolio. Hint: You can only allocate items to buckets that do not have lower-level buckets. Portfolio Item Details 2/2 Figure 43: Portfolio Item Details 2/2 When you create an item, you must always specify a portfolio item type or an item template. The portfolio item type specifies several properties of the item, such as decision points. In addition to the portfolio item type, the item template includes additional master data, such as area and priority. You have different options for creating items. You can create items individually or you can create multiple items at the same time. In addition, you can use an interface in the PPM core system to generate portfolio items based on a Microsoft Excel file. The data of an item is summarized on various tab pages. The General Information tab page, for example, contains the name, external identification, and description of the item. The General Information tab also includes information about the planned, expected, and actual start and end of the item. In addition, you can enter information about the status, location, category, and priority of the item. You can also define critical success factors, such as the probability of technical and commercial success or the assessed risk of the item. The Additional Information tab contains details about the actual decision point, for example, the status. However, changes to the decision point are not specified here but on the separate Phases and Decisions tab. Unit 3: Portfolio Items and Initiatives Configuration and Creation © Copyright. All rights reserved. 64
73.
7/26/2020 SAP e-book 1/1 On
the Financial Information tab, you can select the currency and period breakdown for financial planning at the item level. These fields are mandatory, but the item automatically transfers the values from the parent bucket as default values when you create it. On this tab page, you can define values for the estimated launch and development costs as well as the net present value of the item. Together with the probabilities for technical and commercial success, the system calculates the expected commercial value of this item. The fields for the planned, actual, and budget values are derived from the financial planning data or by integration of the item with a FI/CO system. On the Capacity Information tab, you can decide which time unit you want to use for capacity planning. You can also define the actual headcount of the item for informational purposes. On the Authorizations tab, navigated to by Miscellaneous→ Authorizations, you can add new users that have authorizations, for example, to read or change the item, or you can change the authorizations inherited from the parent bucket. In the same way as for the buckets, you can also enter additional information for items on the Note tab, navigated to by Documents and Notes→ Notes. When you add a note, the system automatically adds details about the person who enters the note, and the time it was added. Companies need additional fields for informational purposes at the item level. These customer fields can be defined in the PPM core system. The customer fields are then shown on the tab pages in the items. Portfolio Item Dependencies It is not possible to observe the schedule of individual portfolio items in isolation. You must also take time dependencies between several portfolio items into consideration during planning and execution. To do so, you can create Dependencies in PPM. Using a dependency, you link a portfolio item with another item in the form of a predecessor-successor relationship. There are various dependency types: Finish to Start, Finish to Finish, Start to Start, and Start to Finish. A portfolio item can have dependencies to several other portfolio items. Using the dependencies dashboard, you can analyze existing dependencies for an item in a table. Traffic light functions help you track time-critical situations at a glance. You create dependencies from a portfolio item. For each dependency, you must enter a name, an external ID, the dependency type, and a portfolio item as a predecessor to the current item. If required, you can also specify a description and comment. The system now automatically determines the planned dates of the current item and the predecessor. When saving, the system uses the planned dates and the dependency type to calculate a dependency risk. In the detail screen of a dependency and in the dependencies dashboard, the dependency risk of a dependency is displayed in the form of an icon. The dependency risk reflects the buffer between the planned dates of the predecessor and successor according to the dependency type. For example, using the dependency type Finish to Start, the system calculates the difference between the planned start date of the current item and the planned finish date of the predecessor. The number of days determined in this way is then assigned to an icon. The item dependency status defines dependency status groups that determine the level of risk for item dependencies. For each dependency status group, you set upper and lower limits in days and then assign an appropriate status icon to each limit. You can define as many dependency status groups as you like, in ascending order of severity starting from 1. Lesson: Creating Portfolio Items © Copyright. All rights reserved. 65
74.
7/26/2020 SAP e-book 1/1 Portfolio
Item Templates Figure 44: Item Template Overview An item template serves as a template for creating new portfolio items. You create and manage item templates in the administration area. The templates always refer to a portfolio bucket. The global template specifies whether the template can be used as a template only in this bucket or also in other buckets of the same portfolio. The figure, Item Template Overview, shows the creation of an item template. You create item templates using the same tab pages as portfolio items. They have almost an identical master data. This way, you can also assign decision points to item templates. You can also link item templates to project templates from Project Management. However, this link is established in Customizing for the PPM core system and not in the administration area. Item templates have their own status management. You use the statuses Created, Active, and Completed to specify whether an item template may be used as a template. You can change the statuses in any order. The status Created is the initial status. The status is supposed to describe the life-cycle of a template. LESSON SUMMARY You should now be able to: ● Create portfolio items ● Create portfolio items with item templates Unit 3: Portfolio Items and Initiatives Configuration and Creation © Copyright. All rights reserved. 66
75.

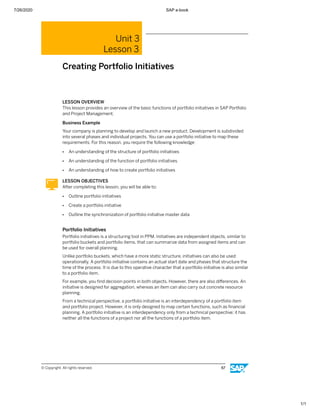

7/26/2020 SAP e-book 1/1 Unit
3 Lesson 3 Creating Portfolio Initiatives LESSON OVERVIEW This lesson provides an overview of the basic functions of portfolio initiatives in SAP Portfolio and Project Management. Business Example Your company is planning to develop and launch a new product. Development is subdivided into several phases and individual projects. You can use a portfolio initiative to map these requirements. For this reason, you require the following knowledge: ● An understanding of the structure of portfolio initiatives ● An understanding of the function of portfolio initiatives ● An understanding of how to create portfolio initiatives LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline portfolio initiatives ● Create a portfolio initiative ● Outline the synchronization of portfolio initiative master data Portfolio Initiatives Portfolio initiatives is a structuring tool in PPM. Initiatives are independent objects, similar to portfolio buckets and portfolio items, that can summarize data from assigned items and can be used for overall planning. Unlike portfolio buckets, which have a more static structure, initiatives can also be used operationally. A portfolio initiative contains an actual start date and phases that structure the time of the process. It is due to this operative character that a portfolio initiative is also similar to a portfolio item. For example, you find decision points in both objects. However, there are also differences. An initiative is designed for aggregation, whereas an item can also carry out concrete resource planning. From a technical perspective, a portfolio initiative is an interdependency of a portfolio item and portfolio project. However, it is only designed to map certain functions, such as financial planning. A portfolio initiative is an interdependency only from a technical perspective; it has neither all the functions of a project nor all the functions of a portfolio item. © Copyright. All rights reserved. 67
76.
7/26/2020 SAP e-book 1/1 Portfolio
Initiative Assignment Figure 45: Structure of a Portfolio Initiative A portfolio initiative consists of master data that is created in the head of the initiative. Phases and decision points are already created when the initiative is created. Both are used to map the progress of the initiative. Phases and decision points are not created manually but according to the PPM configuration. There is no initiative without a phase or decision point. An assignment to a portfolio bucket is already created when the initiative is created. The figure, Structure of a Portfolio Initiative, shows the basic structure of an initiative and its links to other objects. In the course of editing an initiative, you can also consecutively create new portfolio items and assign existing ones. Such portfolio items are then assigned to the initiative as well as to a portfolio bucket, which also means that initiatives enable a different and additional perspective of portfolio items than portfolio buckets. You can keep using portfolio items without an assignment to an initiative. An advantage of assigning several items to an initiative is that master data or authorizations can be exchanged. Authorizations can be inherited in a top-down manner. Scheduling data can then be inherited in a bottom-up manner, which implies that you can simplify data maintenance. Changed data can be kept synchronously. In PPM, there are two scenarios for this purpose: horizontal and vertical data synchronization. You are not limited to the two objects, initiative and item, either. The synchronization of data is a part of Decision Flow Management (DFM), which was introduced with SAP Resource and Portfolio Management (SAP RPM) 4.5. Unit 3: Portfolio Items and Initiatives Configuration and Creation © Copyright. All rights reserved. 68
77.

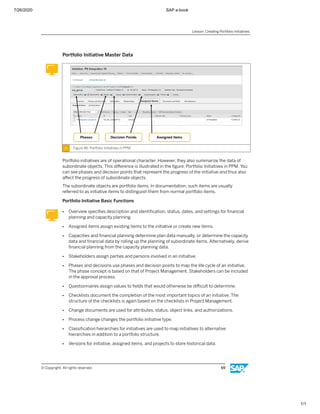

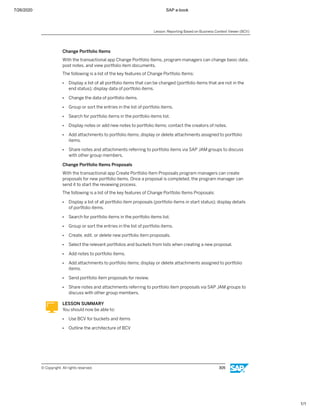

7/26/2020 SAP e-book 1/1 Portfolio
Initiative Master Data Figure 46: Portfolio Initiatives in PPM Portfolio initiatives are of operational character. However, they also summarize the data of subordinate objects. This difference is illustrated in the figure, Portfolio Initiatives in PPM. You can see phases and decision points that represent the progress of the initiative and thus also affect the progress of subordinate objects. The subordinate objects are portfolio items. In documentation, such items are usually referred to as initiative items to distinguish them from normal portfolio items. Portfolio Initiative Basic Functions ● Overview specifies description and identification, status, dates, and settings for financial planning and capacity planning. ● Assigned items assign existing items to the initiative or create new items. ● Capacities and financial planning determine plan data manually, or determine the capacity data and financial data by rolling up the planning of subordinate items. Alternatively, derive financial planning from the capacity planning data. ● Stakeholders assign parties and persons involved in an initiative. ● Phases and decisions use phases and decision points to map the life cycle of an initiative. The phase concept is based on that of Project Management. Stakeholders can be included in the approval process. ● Questionnaires assign values to fields that would otherwise be difficult to determine. ● Checklists document the completion of the most important topics of an initiative. The structure of the checklists is again based on the checklists in Project Management. ● Change documents are used for attributes, status, object links, and authorizations. ● Process change changes the portfolio initiative type. ● Classification hierarchies for initiatives are used to map initiatives to alternative hierarchies in addition to a portfolio structure. ● Versions for initiative, assigned items, and projects to store historical data. Lesson: Creating Portfolio Initiatives © Copyright. All rights reserved. 69
78.

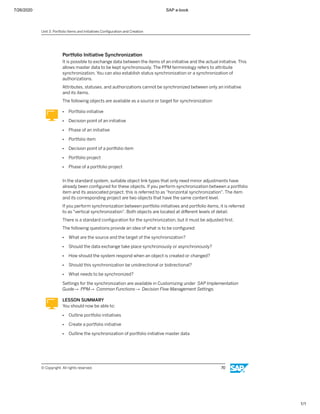

7/26/2020 SAP e-book 1/1 Portfolio

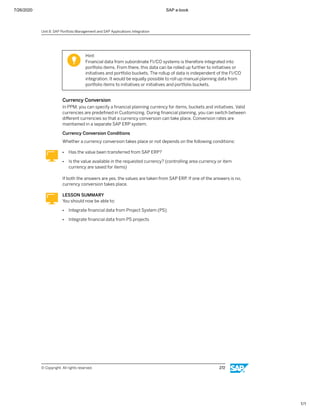

Initiative Synchronization It is possible to exchange data between the items of an initiative and the actual initiative. This allows master data to be kept synchronously. The PPM terminology refers to attribute synchronization. You can also establish status synchronization or a synchronization of authorizations. Attributes, statuses, and authorizations cannot be synchronized between only an initiative and its items. The following objects are available as a source or target for synchronization: ● Portfolio initiative ● Decision point of an initiative ● Phase of an initiative ● Portfolio item ● Decision point of a portfolio item ● Portfolio project ● Phase of a portfolio project In the standard system, suitable object link types that only need minor adjustments have already been configured for these objects. If you perform synchronization between a portfolio item and its associated project, this is referred to as "horizontal synchronization". The item and its corresponding project are two objects that have the same content level. If you perform synchronization between portfolio initiatives and portfolio items, it is referred to as "vertical synchronization". Both objects are located at different levels of detail. There is a standard configuration for the synchronization, but it must be adjusted first. The following questions provide an idea of what is to be configured: ● What are the source and the target of the synchronization? ● Should the data exchange take place synchronously or asynchronously? ● How should the system respond when an object is created or changed? ● Should this synchronization be unidirectional or bidirectional? ● What needs to be synchronized? Settings for the synchronization are available in Customizing under SAP Implementation Guide→ PPM→ Common Functions→ Decision Flow Management Settings. LESSON SUMMARY You should now be able to: ● Outline portfolio initiatives ● Create a portfolio initiative ● Outline the synchronization of portfolio initiative master data Unit 3: Portfolio Items and Initiatives Configuration and Creation © Copyright. All rights reserved. 70
79.
7/26/2020 SAP e-book 1/1 Unit
3 Learning Assessment 1. You can adjust the system settings in a way that a portfolio project is not created automatically when you create a portfolio item. Determine whether this statement is true or false. X True X False 2. To be able to select a technology type in an item, you must always first select the category to which the item belongs. Determine whether this statement is true or false. X True X False 3. You can assign items to buckets that have lower-level buckets. Determine whether this statement is true or false. X True X False 4. Which dependency type is used to calculate the difference between the planned start date of the current item and the planned finish date of the predecessor? Choose the correct answer. X A Finish to Start X B Finish to Finish X C Start to Start X D Start to Finish © Copyright. All rights reserved. 71
80.
7/26/2020 SAP e-book 1/1 5.

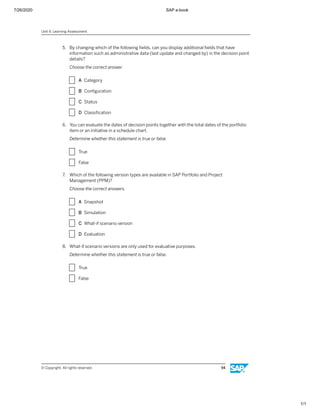

Which of the following elements do you use to map the progress of a portfolio initiative? Choose the correct answers. X A Phases X B Decision points X C Checklists X D Checklist items 6. Portfolio initiatives summarize the data of subordinate items. Determine whether this statement is true or false. X True X False 7. What type of synchronization is performed between portfolio initiatives and portfolio items? Choose the correct answer. X A Horizontal synchronization X B Vertical synchronization X C Linear synchronization Unit 3: Learning Assessment © Copyright. All rights reserved. 72
81.

7/26/2020 SAP e-book 1/1 Unit
3 Learning Assessment - Answers 1. You can adjust the system settings in a way that a portfolio project is not created automatically when you create a portfolio item. Determine whether this statement is true or false. X True X False Correct. You can adjust the system settings in a way that a portfolio project is not created automatically when you create a portfolio item. 2. To be able to select a technology type in an item, you must always first select the category to which the item belongs. Determine whether this statement is true or false. X True X False Correct. To select a technology type in an item, you must always first select the category to which the item belongs. 3. You can assign items to buckets that have lower-level buckets. Determine whether this statement is true or false. X True X False Correct. You can only allocate items to buckets that do not have lower-level buckets. © Copyright. All rights reserved. 73
82.
7/26/2020 SAP e-book 1/1 4.
Which dependency type is used to calculate the difference between the planned start date of the current item and the planned finish date of the predecessor? Choose the correct answer. X A Finish to Start X B Finish to Finish X C Start to Start X D Start to Finish Correct. The Finish to Start dependency type is used to calculate the difference between the planned start date of the current item and the planned finish date of the predecessor. 5. Which of the following elements do you use to map the progress of a portfolio initiative? Choose the correct answers. X A Phases X B Decision points X C Checklists X D Checklist items Correct. Phases and decision points are used to map the progress of the initiative. 6. Portfolio initiatives summarize the data of subordinate items. Determine whether this statement is true or false. X True X False Correct. Portfolio initiatives summarize the data of subordinate items. 7. What type of synchronization is performed between portfolio initiatives and portfolio items? Choose the correct answer. X A Horizontal synchronization X B Vertical synchronization X C Linear synchronization Correct. If you perform synchronization between portfolio initiatives and portfolio items, it is referred to as vertical synchronization. Unit 3: Learning Assessment - Answers © Copyright. All rights reserved. 74
83.
7/26/2020 SAP e-book 1/1 UNIT
4 Portfolio Items and Initiatives Management Lesson 1 Managing Authorizations 76 Lesson 2 Using Statuses and Workflows for Portfolio Items 81 Lesson 3 Using Decision Points 85 Lesson 4 Creating Versions of Portfolio Items 88 Lesson 5 Managing Reviews 90 UNIT OBJECTIVES ● Outline user administration ● Outline authorizations in SAP PPM ● Define status for portfolio items ● Check workflow for portfolio items ● Configure decision points ● Change decision points ● Create portfolio item versions ● Manage reviews © Copyright. All rights reserved. 75
84.
7/26/2020 SAP e-book 1/1 Unit

4 Lesson 1 Managing Authorizations LESSON OVERVIEW In this lesson, we will discuss the administration of users in the various SAP PPM relevant systems and the linking of these systems to business partners. We will also deal with the authorization concept of SAP PPM in detail. Business Example It is your responsibility that all intended users for SAP PPM in your company receive user names and authorizations for processing objects in SAP PPM. Therefore, you want to familiarize yourself with the SAP PPM user administration and authorization concept. For this reason, you require the following knowledge: ● An understanding of SAP PPM user administration ● An understanding of the SAP PPM authorization concept LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline user administration ● Outline authorizations in SAP PPM User Administration There are several processes in which data from various systems are consolidated in SAP Portfolio and Project Management in S/4HANA (PPM). This means that project data and financial details can be uploaded from SAP Project System to PPM, or data from BI can be made available in PPM for evaluation purposes. © Copyright. All rights reserved. 76
85.
7/26/2020 SAP e-book 1/1 Figure
47: Users and Systems You can create and update business partner data by distributing data from SAP Human Capital Management (SAP HCM) systems. Even PPM itself is based on two systems – the PPM core system and SAP Enterprise Portal. By assigning your own users and roles in the relevant systems, you ensure that data security and authorizations can be managed separately in the individual systems. Using the Single Sign On (SSO) technology, you can avoid the need for separate logon screens, despite the different system users. In the portal, you can also map portal users to the users and their passwords in other systems, which simplifies cross-system data processing in the portal. Portfolios and their items in PPM are edited using SAP Enterprise Portal. To log on to the portal, you require a portal user. There are various options for logging on to the portal itself. The system uses the standard authentication method when you enter the user identification and password. Portal users are created and managed in the portal user administration. By assigning portal roles to portal users, you determine which content a user can access and which navigation options should be available in the Web browser. For PPM, the showcase portal role com.sap.pct.cprxrpm.port_mgmt_showcase (Portfolio Management) is delivered in the standard system. Lesson: Managing Authorizations © Copyright. All rights reserved. 77
86.

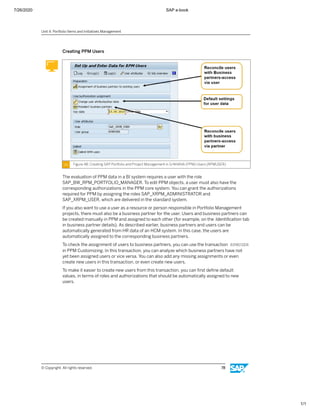

7/26/2020 SAP e-book 1/1 Creating
PPM Users Figure 48: Creating SAP Portfolio and Project Management in S/4HANA (PPM) Users (RPMUSER) The evaluation of PPM data in a BI system requires a user with the role SAP_BW_RPM_PORTFOLIO_MANAGER. To edit PPM objects, a user must also have the corresponding authorizations in the PPM core system. You can grant the authorizations required for PPM by assigning the roles SAP_XRPM_ADMINISTRATOR and SAP_XRPM_USER, which are delivered in the standard system. If you also want to use a user as a resource or person responsible in Portfolio Management projects, there must also be a business partner for the user. Users and business partners can be created manually in PPM and assigned to each other (for example, on the Identification tab in business partner details). As described earlier, business partners and users can be automatically generated from HR data of an HCM system. In this case, the users are automatically assigned to the corresponding business partners. To check the assignment of users to business partners, you can use the transaction RPMUSER in PPM Customizing. In this transaction, you can analyze which business partners have not yet been assigned users or vice versa. You can also add any missing assignments or even create new users in this transaction, or even create new users. To make it easier to create new users from this transaction, you can first define default values, in terms of roles and authorizations that should be automatically assigned to new users. Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 78
87.
7/26/2020 SAP e-book 1/1 Authorizations

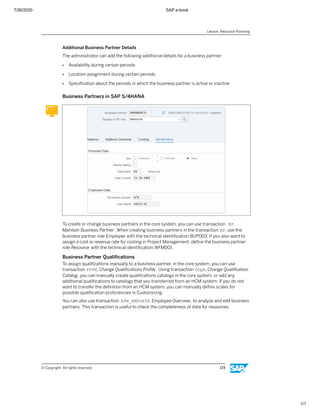

in PPM Figure 49: PPM Authorization Concept The PPM authorization concept is based on the authorizations that you assign to the users in the PPM core system and the authorizations that you make available to users in access control lists (ACLs) according to the object. For the user to be able to actually edit objects in PPM, the SAP standard role SAP_XRPM_USER must be assigned to their user in the PPM core system. To be allowed to perform administrator functions in PPM, in particular for creating a portfolio, the SAP user must also include the role SAP_XRPM_Administrator. However, a user must also have the relevant authorizations to display or edit an object in SAP PPM. These object-specific authorizations are implemented using the ACLs. Authorizations that you give to a user for a portfolio object are also inherited to the subordinate objects. You can also change or completely remove the inherited authorizations in the subordinate objects. These changes are then inherited to the next subordinate objects in turn. You can grant object-specific authorizations directly for individual users, and you can also grant authorizations for user roles. All users with these user roles automatically have the corresponding authorizations. You can assign the following activities to users or user roles for an authorization check: ● Admin All authorizations; this authorization is automatically assigned to the user who created the object. ● Write Authorization to change and display the object data. ● Read Authorization to display the object data. ● None No authorization for the object; used to remove inherited authorizations. Lesson: Managing Authorizations © Copyright. All rights reserved. 79
88.
7/26/2020 SAP e-book 1/1 You

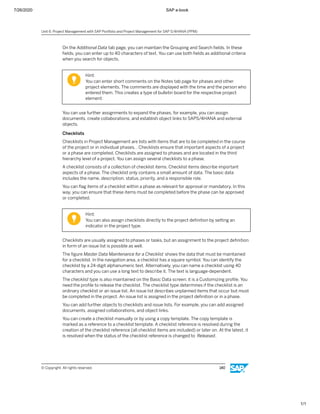

can also define a substitute in PPM for portfolios, portfolio buckets and items, as well as for collections and reviews. Your substitute has the same authorizations in the assigned object as you. You can delete the name of your substitute when they are not required. If you are a substitute for a particular bucket, you will see the same information about the object as the delegating user. Hint: Additional user roles and object-specific authorizations are required to edit Portfolio Management objects. LESSON SUMMARY You should now be able to: ● Outline user administration ● Outline authorizations in SAP PPM Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 80
89.

7/26/2020 SAP e-book 1/1 Unit
4 Lesson 2 Using Statuses and Workflows for Portfolio Items LESSON OVERVIEW This lesson deals with the status management of portfolio items. It also discusses workflows that can be used in SAP Portfolio and Project Management to inform the responsible users about changes in portfolio items or status. Business Example You want to use status in portfolio items to provide the portfolio and item managers with a quick overview of the processing status of their portfolio items. If there are status changes, the relevant person should be automatically notified of the changes. Therefore, you want an overview of the status management and workflows of SAP Portfolio and Project Management. For this reason, you require the following knowledge: ● An understanding of status management for portfolio items ● An understanding of settings for workflows in SAP Portfolio and Project Management LESSON OBJECTIVES After completing this lesson, you will be able to: ● Define status for portfolio items ● Check workflow for portfolio items © Copyright. All rights reserved. 81
90.

7/26/2020 SAP e-book 1/1 Portfolio
Item Status Figure 50: Definition of Statuses for Portfolio Items The status in PPM documents the status of objects, such as portfolio items, decision points, reviews, or what-if scenarios. Unlike in Project Management, the status in PPM does not control which business transactions are allowed or not allowed by default. However, the change of status can trigger workflows that automatically inform the person responsible of these status changes. Hint: Initiatives use a different status management. For initiatives, the status logic is derived from Project Management, which means it is possible to define additional user statuses for initiatives. Statuses are defined centrally in PPM Customizing in the portfolio-independent settings. Examples of statuses that are delivered as a standard are Inactive, In Preparation, In Progress, Approved, or Closed. You can also create your own statuses in Customizing. The definition of a status requires only an identification and a text. You define which statuses can be used for portfolio items and their decision points in the definition of the portfolio item types. When you do this, you also decide the sequence of the statuses in the items or decision points. In the definition of the portfolio types, you define which statuses should be available for reviews and what-if scenarios, and the possible sequence of these statuses. When you assign a status to a portfolio item type, you can also define a status group. The status group controls the tab pages of the item dashboard on which a portfolio item should be displayed when the corresponding status is active. The tab pages enable you to limit the display of portfolio items in the dashboard. There are different tab pages like All Items, Active Items, , Active Suggestions Active Escalations, or Inactive Items. When defining the status sequence for items and decision points, you can also make a setting, which ensures that the users responsible receive an e-mail due to this status change. For this, assign a workflow ID to the corresponding status change. Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 82
91.

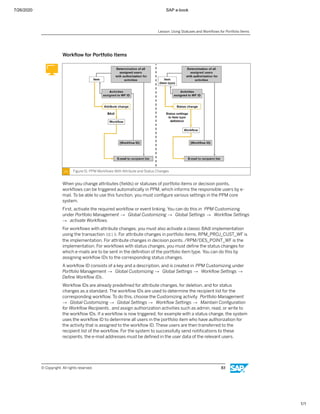

7/26/2020 SAP e-book 1/1 Workflow
for Portfolio Items Figure 51: PPM Workflows With Attribute and Status Changes When you change attributes (fields) or statuses of portfolio items or decision points, workflows can be triggered automatically in PPM, which informs the responsible users by e- mail. To be able to use this function, you must configure various settings in the PPM core system. First, activate the required workflow or event linking. You can do this in PPM Customizing under Portfolio Management → Global Customizing → Global Settings → Workflow Settings → activate Workflows. For workflows with attribute changes, you must also activate a classic BAdI implementation using the transaction SE19. For attribute changes in portfolio items, RPM_PROJ_CUST_WF is the implementation. For attribute changes in decision points, /RPM/DES_POINT_WF is the implementation. For workflows with status changes, you must define the status changes for which e-mails are to be sent in the definition of the portfolio item type. You can do this by assigning workflow IDs to the corresponding status changes. A workflow ID consists of a key and a description, and is created in PPM Customizing under Portfolio Management → Global Customizing → Global Settings → Workflow Settings → Define Workflow IDs. Workflow IDs are already predefined for attribute changes, for deletion, and for status changes as a standard. The workflow IDs are used to determine the recipient list for the corresponding workflow. To do this, choose the Customizing activity Portfolio Management → Global Customizing → Global Settings → Workflow Settings → Maintain Configuration for Workflow Recipients, and assign authorization activities such as admin, read, or write to the workflow IDs. If a workflow is now triggered, for example with a status change, the system uses the workflow ID to determine all users in the portfolio item who have authorization for the activity that is assigned to the workflow ID. These users are then transferred to the recipient list of the workflow. For the system to successfully send notifications to these recipients, the e-mail addresses must be defined in the user data of the relevant users. Lesson: Using Statuses and Workflows for Portfolio Items © Copyright. All rights reserved. 83
92.
7/26/2020 SAP e-book 1/1 If
required, the notification may also contain a link to the object, for example, the portfolio item. For this, you must define a suitable web server alias in Customizing. The alias must contain the identification of the logical system which is assigned to the client. If you use SAP Enterprise Portal, you must assign the parameter PORTALLINK to this alias and enter the URL of the portal as a parameter value. LESSON SUMMARY You should now be able to: ● Define status for portfolio items ● Check workflow for portfolio items Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 84
93.
7/26/2020 SAP e-book 1/1 Unit
4 Lesson 3 Using Decision Points LESSON OVERVIEW This lesson provides an overview of the use of decision points and the corresponding Customizing in SAP Portfolio and Project Management. Business Example The portfolio items of your portfolio have a life cycle, which can begin with the creation within a proposal phase for example, followed by various planning and approval phases, and which can finally end with implementation and closing. You want to be able to trace in detail the progress of the life cycle of your portfolio items in SAP Portfolio and Project Management. Therefore, you want to define decision points in SAP Portfolio and Project Management Customizing. For this reason, you require the following knowledge: ● An understanding of decision points in SAP Portfolio and Project Management Customizing ● An understanding of how to use decision points to map the life cycle of portfolio items LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure decision points ● Change decision points © Copyright. All rights reserved. 85
94.

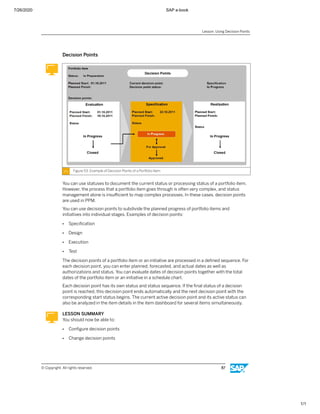

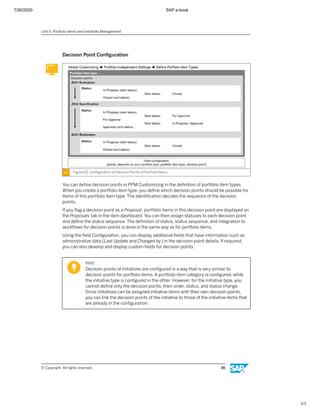

7/26/2020 SAP e-book 1/1 Decision
Point Configuration Figure 52: Configuration of Decision Points of Portfolio Items You can define decision points in PPM Customizing in the definition of portfolio item types. When you create a portfolio item type, you define which decision points should be possible for items of this portfolio item type. The identification decides the sequence of the decision points. If you flag a decision point as a Proposal, portfolio items in this decision point are displayed on the Proposals tab in the item dashboard. You can then assign statuses to each decision point and define the status sequence. The definition of status, status sequence, and integration to workflows for decision points is done in the same way as for portfolio items. Using the field Configuration, you can display additional fields that have information such as administrative data (Last Update and Changed by) in the decision point details. If required, you can also develop and display custom fields for decision points. Hint: Decision points of initiatives are configured in a way that is very similar to decision points for portfolio items. A portfolio item category is configured, while the initiative type is configured in the other. However, for the initiative type, you cannot define only the decision points, their order, status, and status change. Since initiatives can be assigned initiative items with their own decision points, you can link the decision points of the initiative to those of the initiative items that are already in the configuration. Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 86
95.
7/26/2020 SAP e-book 1/1 Decision
Points Figure 53: Example of Decision Points of a Portfolio Item You can use statuses to document the current status or processing status of a portfolio item. However, the process that a portfolio item goes through is often very complex, and status management alone is insufficient to map complex processes. In these cases, decision points are used in PPM. You can use decision points to subdivide the planned progress of portfolio items and initiatives into individual stages. Examples of decision points: ● Specification ● Design ● Execution ● Test The decision points of a portfolio item or an initiative are processed in a defined sequence. For each decision point, you can enter planned, forecasted, and actual dates as well as authorizations and status. You can evaluate dates of decision points together with the total dates of the portfolio item or an initiative in a schedule chart. Each decision point has its own status and status sequence. If the final status of a decision point is reached, this decision point ends automatically and the next decision point with the corresponding start status begins. The current active decision point and its active status can also be analyzed in the item details in the item dashboard for several items simultaneously. LESSON SUMMARY You should now be able to: ● Configure decision points ● Change decision points Lesson: Using Decision Points © Copyright. All rights reserved. 87
96.
7/26/2020 SAP e-book 1/1 Unit
4 Lesson 4 Creating Versions of Portfolio Items LESSON OVERVIEW This lesson deals with the creation and evaluation of snapshots, versions of a portfolio item that can be used to document the progress of the item. Business Example You want to document the changes that are made to portfolio items in the course of time. For this purpose, you create a snapshot version of the item and record the development. You then want to use the version history to analyze which snapshots were already created. For this reason, you require the following knowledge: ● An understanding of how to create snapshots of portfolio items ● An understanding of how to use the SAP PPM version history LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create portfolio item versions Portfolio Item Versions Figure 54: Creating a Version Versions in PPM are copies of portfolio items. Versions contain item details and additional version data such as a version description and identification. In the details of a version, the © Copyright. All rights reserved. 88
97.
7/26/2020 SAP e-book 1/1 system
also records who created the version. You can also add a description or comment to the version details. When you create a version, specify a version type. The following version types are available in PPM: ● Snapshot (version type 01) ● What-if scenario version (version type 02) What-if scenario versions are changeable versions of a portfolio item that you can use to simulate changes without changing the data of an operative portfolio item. You can create what-if scenario versions for individual portfolio items, for all items of a portfolio item or for the items of a what-if scenario in reviews. Snapshots are versions of portfolio items, which document the status of an item at the time the version was created. Therefore, snapshots are not changeable versions of items. You can create a snapshot of a portfolio item while processing the item using the activity Create New Version . You can also create versions for all items of a portfolio bucket. To do this, call the item dashboard of the corresponding portfolio bucket and choose the activity Take Snapshot of All Items. Then, enter the version data for all item versions. Note that depending on the number of items in the portfolio bucket, the creation of the snapshot may take some time. LESSON SUMMARY You should now be able to: ● Create portfolio item versions Lesson: Creating Versions of Portfolio Items © Copyright. All rights reserved. 89
98.
7/26/2020 SAP e-book 1/1 Unit
4 Lesson 5 Managing Reviews LESSON OVERVIEW This lesson shows how reviews in SAP Portfolio and Project Management (SAP PPM) help you to analyze portfolio items, compare them and make decisions about their further processing. The lesson also explains how to use what-if scenarios to simulate changes to portfolio items, without having to make direct changes to the original portfolio items. Business Example As a portfolio manager, you and other decision makers must decide which proposals for new projects are now to be actually implemented and which current projects are to be sponsored further or stopped, if necessary. You want to use reviews in SAP PPM to support the decision making process. You also want to create what-if scenarios to document the possible changes in SAP PPM. For this reason, you require the following knowledge: ● An understanding of reviews ● An understanding of what-if scenarios LESSON OBJECTIVES After completing this lesson, you will be able to: ● Manage reviews Reviews Figure 55: Scoreboard Not only the data of portfolio items is evaluated within a review, but various change options of portfolio items are also considered and their effects are discussed. What-if scenarios are © Copyright. All rights reserved. 90

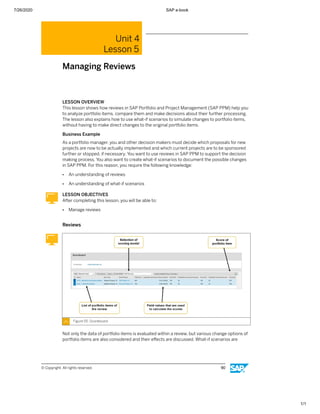

99.

7/26/2020 SAP e-book 1/1 available
in PPM to support this process. What-if scenarios can be created within reviews and include all or only the selected portfolio items of the review. When you create a what-if scenario, the system automatically creates alterable copies of the assigned portfolio items, so that a what-if scenario displays a grouping of simulation versions or what-if scenarios of portfolio items. In contrast to snapshot versions, what-if scenario versions are not only used for purely evaluative purposes, but can be used to simulate changes to the portfolio item data, without having to make direct changes to the original items. In a what-if scenario, you have your own reporting cockpit and your own dashboard to evaluate the simulated data and also compare it with the data of the original items. Hint: In addition to items, you can also assign initiatives to reviews. Using Reviews After you create a review and assign portfolio items to it, you can call various views and actions from this review. You can go to an item dashboard or a reporting cockpit to report the portfolio items. Only the items of this review are then displayed in the dashboard or reporting cockpit. To analyze the progress of the portfolio items of the review, you can also call the version history of the items. If you want to simulate changes to portfolio items in a review, without changing the operational items, you can create what-if scenarios within a review. You can use the scoreboard of a review to compare and prioritize portfolio items of a review according to defined criteria. When you open the scoreboard for a review, you first select a scoring model on which the comparison and prioritizing is to be based. A scoring model is defined in Customizing for PPM and contains a selection of portfolio item fields, each of which can be weighted differently in strength. For each field (attribute) of a scoring model, you also define a scoring for the possible field values in Customizing. The system can determine a total score for a portfolio item based on the scoring of the field values of a portfolio item and the weighting of the fields. After you select a scoring model in the scoreboard, the score of the portfolio items of the review and the field values of the individual items, which are used to calculate the scores, are presented in a tabular manner in the scoreboard. If necessary, you can display details for calculating the scores, sort the portfolio items according to their scores, or export the result to Microsoft Excel. You can change the choice of scoring model at any time, and therefore, you can compare portfolio items in succession based on different criteria. What-if Scenarios Reviews of portfolios are part of a business planning process, and they can be initiated either monthly, quarterly, annually, on certain key dates, or at random. On one hand, reviews are used to check critical success factors of items of a portfolio. On the other hand, reviews can be used within the approval procedure to reach decisions about the selection of suitable projects based on standardized factors. Relevant portfolio managers create reviews in PPM. When you create a review, you assign it to a portfolio bucket. Each review is given a name, an external ID, and a more detailed description, if necessary. When you create a review, you also enter a date on which the portfolio items linked to the review are to be checked. You assign the portfolio items to a review in the Items for Review Lesson: Managing Reviews © Copyright. All rights reserved. 91
100.
7/26/2020 SAP e-book 1/1 section
of the review. You can assign portfolio items of different portfolio buckets to a review; however, a review can only contain items of those portfolios that are assigned to the review. If necessary, you can also change the assignment of portfolio items to a review after you have saved the review. You can assign a status also to reviews. To do so, assign a suitable review status and status sequences to the relevant portfolio types when you define portfolio types in Customizing for PPM. In the Authorizations section of a review, you can manually define which user is to have authorizations for changing or reading the review. You can also change or completely remove authorizations, which the review has inherited from the portfolio bucket to which it is assigned. If you add comments to a review, the details about the user who created them and when they were created are automatically added to the comments and they can be reproduced later. The review dashboard provides you with an overview of existing reviews. The dashboard displays the following elements by default: ● Names of reviews ● Review dates ● Number of portfolio items in the review ● The user who initiated the reviews ● The buckets to which the reviews are assigned Evaluating What-If Scenarios From a review, you can display a list of all what-if scenarios of this review. You can use the general data of the review as sort criteria or filter criteria. By clicking, you can go from here to the processing of a what-if scenario. You have various evaluation options available within a what-if scenario. You can display an item dashboard of the simulations of what-if scenarios and analyze various data of the simulations, depending on the dashboard settings. If you set the Display Original Item indicator, a dashboard with the data of the operational items is displayed in addition to the dashboard of the simulations. This enables you to compare the simulated data with the data of the operational elements. By clicking, you can go from the dashboard to the processing of simulations or the operational items also. A what-if scenario scoreboard is available to simulate the effect of data changes to the prioritization of portfolio items. In this scoreboard, you can perform a scoring of the simulations as well as a scoring of the original items. By clicking, you can go from here to the processing of a simulation, make changes, save them, and then analyze the scoreboard again with the modified simulation data. LESSON SUMMARY You should now be able to: ● Manage reviews Unit 4: Portfolio Items and Initiatives Management © Copyright. All rights reserved. 92
101.
7/26/2020 SAP e-book 1/1 Unit

4 Learning Assessment 1. Using the Single Sign On technology, you can avoid the need for separate logon screens, despite the different system users. Determine whether this statement is true or false. X True X False 2. Which of the following activities authorizes a user to change and display the object data? Choose the correct answer. X A Admin X B Write X C Read X D None 3. When defining the status sequence for items and decision points, you can also make a setting, which ensures that the users responsible receive an e-mail due to a status change. Determine whether this statement is true or false. X True X False 4. What is the implementation for the attribute changes in portfolio items? Choose the correct answer. X A RPM_PROJ_CUST_WF X B /RPM/DES_POINT_W © Copyright. All rights reserved. 93
102.
7/26/2020 SAP e-book 1/1 5.
By changing which of the following fields, can you display additional fields that have information such as administrative data (last update and changed by) in the decision point details? Choose the correct answer. X A Category X B Configuration X C Status X D Classification 6. You can evaluate the dates of decision points together with the total dates of the portfolio item or an initiative in a schedule chart. Determine whether this statement is true or false. X True X False 7. Which of the following version types are available in SAP Portfolio and Project Management (PPM)? Choose the correct answers. X A Snapshot X B Simulation X C What-if scenario version X D Evaluation 8. What-if scenario versions are only used for evaluative purposes. Determine whether this statement is true or false. X True X False Unit 4: Learning Assessment © Copyright. All rights reserved. 94
103.
7/26/2020 SAP e-book 1/1 Unit
4 Learning Assessment - Answers 1. Using the Single Sign On technology, you can avoid the need for separate logon screens, despite the different system users. Determine whether this statement is true or false. X True X False Correct. Using the Single Sign On technology, you can avoid the need for separate logon screens, despite the different system users. 2. Which of the following activities authorizes a user to change and display the object data? Choose the correct answer. X A Admin X B Write X C Read X D None Correct. The Write activity authorizes a user to change and display the object data. 3. When defining the status sequence for items and decision points, you can also make a setting, which ensures that the users responsible receive an e-mail due to a status change. Determine whether this statement is true or false. X True X False Correct. When defining the status sequence for items and decision points, you can also make a setting, which ensures that the users responsible receive an e-mail due to a status change. © Copyright. All rights reserved. 95
104.
7/26/2020 SAP e-book 1/1 4.
What is the implementation for the attribute changes in portfolio items? Choose the correct answer. X A RPM_PROJ_CUST_WF X B /RPM/DES_POINT_W Correct. RPM_PROJ_CUST_WF is the implementation for attribute changes in portfolio items. 5. By changing which of the following fields, can you display additional fields that have information such as administrative data (last update and changed by) in the decision point details? Choose the correct answer. X A Category X B Configuration X C Status X D Classification Correct. By changing the Configuration field, you can display additional fields that have information such as administrative data (last update and changed by) in the decision point details. 6. You can evaluate the dates of decision points together with the total dates of the portfolio item or an initiative in a schedule chart. Determine whether this statement is true or false. X True X False Correct. You can evaluate the dates of decision points together with the total dates of the portfolio item or an initiative in a schedule chart. Unit 4: Learning Assessment - Answers © Copyright. All rights reserved. 96
105.
7/26/2020 SAP e-book 1/1 7.

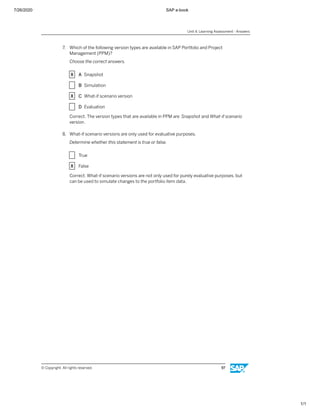

Which of the following version types are available in SAP Portfolio and Project Management (PPM)? Choose the correct answers. X A Snapshot X B Simulation X C What-if scenario version X D Evaluation Correct. The version types that are available in PPM are Snapshot and What-if scenario version. 8. What-if scenario versions are only used for evaluative purposes. Determine whether this statement is true or false. X True X False Correct. What-if scenario versions are not only used for purely evaluative purposes, but can be used to simulate changes to the portfolio item data. Unit 4: Learning Assessment - Answers © Copyright. All rights reserved. 97
106.
7/26/2020 SAP e-book 1/1 UNIT
5 Financial and Capacity Planning Lesson 1 Planning Financial Values 100 Lesson 2 Configuring Financial Planning 106 Lesson 3 Configuring Financial Planning by Integration 109 Lesson 4 Planning Capacity 112 Lesson 5 Configuring Capacity Planning 117 Lesson 6 Configuring Capacity Planning by Integration 120 UNIT OBJECTIVES ● Outline financial planning ● Enter the financial values manually ● Check the financial planning rollup ● Outline financial planning by integration ● Configure financial planning ● Outline the configuration of financial planning by integration ● Outline capacity planning ● Enter capacity planning values manually ● Check the capacity planning rollup © Copyright. All rights reserved. 98
107.

7/26/2020 SAP e-book 1/1 ●
Outline capacity planning by integration ● Configure capacity planning ● Outline the configuration of capacity planning by integration © Copyright. All rights reserved. 99
108.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 1 Planning Financial Values LESSON OVERVIEW This lesson provides an overview of planning financial values. Business Example As a portfolio manager, you have created buckets and items. So far, you have entered planned start and finish dates. Now, you want to plan financial data for the items for which you are responsible. For this reason, you require the following knowledge: ● An understanding of how to perform financial planning for portfolio items ● An understanding of how to perform financial planning for portfolio buckets ● An understanding of the terms financial category, group, and view ● An understanding of the scenarios for integration of financial planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline financial planning ● Enter the financial values manually ● Check the financial planning rollup ● Outline financial planning by integration © Copyright. All rights reserved. 100

109.

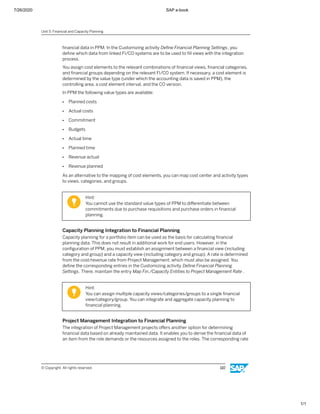

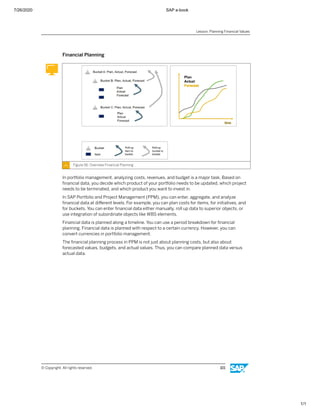

7/26/2020 SAP e-book 1/1 Financial

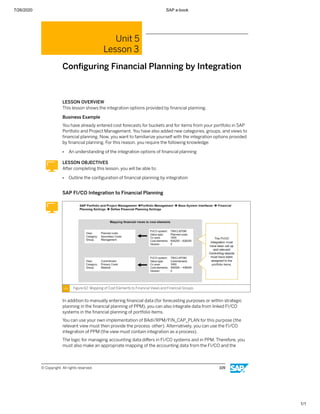

Planning Figure 56: Overview Financial Planning In portfolio management, analyzing costs, revenues, and budget is a major task. Based on financial data, you decide which product of your portfolio needs to be updated, which project needs to be terminated, and which product you want to invest in. In SAP Portfolio and Project Management (PPM), you can enter, aggregate, and analyze financial data at different levels. For example, you can plan costs for items, for initiatives, and for buckets. You can enter financial data either manually, roll up data to superior objects, or use integration of subordinate objects like WBS elements. Financial data is planned along a timeline. You can use a period breakdown for financial planning. Financial data is planned with respect to a certain currency. However, you can convert currencies in portfolio management. The financial planning process in PPM is not just about planning costs, but also about forecasted values, budgets, and actual values. Thus, you can compare planned data versus actual data. Lesson: Planning Financial Values © Copyright. All rights reserved. 101
110.
7/26/2020 SAP e-book 1/1 Financial
Categories, Groups, and Views Figure 57: Concept of Categories, Groups, and Views Financial planning in PPM is based on categories, groups, and views, which are predefined. The following are financial categories, groups, and views: ● Category Primary costs, secondary costs ● Group Cost for material, cost for services ● View Planned costs, forecasted costs In SAP ERP systems, you find very detailed cost-planning based on cost elements. These cost elements are summarized to cost elements groups. Although financial planning in SAP Portfolio Management is not as detailed as it is in SAP ERP, the structure of financial planning is similar. The term view in PPM corresponds to the term value type of SAP ERP. As an administrator for PPM, you can set up your own categories for your company. You can subdivide your own categories in your own groups. Finally, you set up views as per the needs of your company. As a portfolio manager you can start planning from different points of views. Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 102
111.
7/26/2020 SAP e-book 1/1 Manual
Financial Planning Figure 58: Manual Financial Planning The figure, Manual Financial Planning, shows financial planning with three different hierarchies. During financial planning, you can switch between these hierarchies. Once categories, groups, and views are predefined, you can start financial planning. The figure demonstrates manual financial planning for a portfolio item. In this case, the view Forecast is predefined for manual planning. Therefore, you can enter forecasted costs for all periods within the planning interval. You can use a currency for financial planning. Currency conversations can be calculated with PPM based on conversion rates. However, currency conversion is not as detailed as it is in SAP ERP. Manual financial planning is available for portfolio items, initiatives, and buckets. You can set up specific views for different objects. For example, you can set up the views Forecasted cost of items, Forecasted for Buckets , and Forecasted for Initiatives . Hint: You can use distribution functions to enter financial planning data. The distribution functions allow you to distribute values across several periods. For example, you can distribute an additional €10,000 per month over the next twelve months. Without distribution functions, you must adjust the twelve months individually. As additional information, you can define portfolio buckets as sponsors by default for the various financial groups. In this way, you can document that another portfolio bucket bears certain costs of a portfolio item. However, a value flow does not occur between the portfolio bucket and the item. Financial Planning Rollup In Portfolio Management, you define portfolios as hierarchies made up of different levels of buckets. Portfolio items are assigned to the lowest level buckets. Financial data planned at the Lesson: Planning Financial Values © Copyright. All rights reserved. 103
112.
7/26/2020 SAP e-book 1/1 level
of items can be rolled up to the superior bucket. For example, you enter the financial planning view Forecast for an item manually. The Forecast view is rolled up to the respective view of the bucket. You cannot manually change the Forecast view for the bucket. A view is either rolled up to the bucket or maintained manually. A rollup of planning data is possible from an item to a superior bucket. A rollup is also possible from a bucket to a superior bucket. If you make use of initiatives, a rollup is possible from an initiative item to a superior initiative to a superior bucket. Details of the rollup process are set up in the configuration of views. Financial Planning by Integration Figure 59: Financial Planning by Integration In PPM, financial planning data is entered manually, rolled up, or calculated by integration of financial planning of subordinate objects. For example, an internal order of an SAP ERP system is assigned to a portfolio item. The cost element-based cost planning of the internal order can be integrated with a financial planning view of the superior item. Integration of financial planning is set up in the configuration of views for financial planning in PPM. However, integration can be enabled for items only. You cannot use integration for buckets or for initiatives. For a number of SAP ERP cost objects, you can integrate cost planning data, budget, actual, and commitments. The figure, Financial Planning by Integration, demonstrates typical cost objects assigned to portfolio items. In addition to SAP ERP objects, you can also integrate cost planning or capacity planning of assigned portfolio projects to items. That is, you can use capacity planning for project management to calculate financial planning for an item. Note: There is no standard delivery or configuration for the integration of financial planning. LESSON SUMMARY You should now be able to: ● Outline financial planning ● Enter the financial values manually ● Check the financial planning rollup Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 104
113.
7/26/2020 SAP e-book 1/1 ●
Outline financial planning by integration Lesson: Planning Financial Values © Copyright. All rights reserved. 105
114.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 2 Configuring Financial Planning LESSON OVERVIEW This lesson shows the settings required for enabling financial planning. Business Example You have already entered cost forecasts for buckets and for items from your portfolio in SAP Portfolio and Project Management. Now, you want to add new categories, groups, and views to financial planning. Therefore, you want to familiarize yourself with the required settings for the manual planning of financial data in SAP Portfolio and Project Management. For this reason, you require the following knowledge: ● An understanding of the required Customizing settings for financial planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure financial planning Financial Planning Configuration Figure 60: Settings for Financial Planning You can configure a number of settings for financial planning in Customizing for SAP Portfolio and Project Management. The figure provides an overview of the settings required for financial planning. Additional settings are required to set up the FI/CO interface. © Copyright. All rights reserved. 106
115.
7/26/2020 SAP e-book 1/1 You
define the type of currencies and period types that are to be used for financial planning for portfolio buckets, items, and initiatives. You define the possible currencies and period types in advance in the Define Currency Units and Define Period Types fields respectively, in Customizing for SAP Portfolio and Project Management. In the Customizing activity Define Financial and Capacity Categories, you create the financial categories and financial groups that you require for financial planning. You first create identifications and texts for the individual financial categories. Following that, you create at least one financial group for each financial category. This group also consists of identifications and descriptive text. Since the introduction of distribution functions, you have the option of maintaining a distribution type, according to calendar days or working days. You create financial views in the Customizing activity Define Financial and Capacity Views. You create an identification and appropriate text for each view that you require for your financial planning. You also define whether the view is to be available at the portfolio item level, initiative level, initiative item level, and/or at the portfolio bucket level. For views at the portfolio item level, you control whether the view permits manual entry, or whether it is to be filled automatically using the FI/CO or Project Management integration or your own BAdI implementation. For views at the portfolio bucket level, you can choose between manual entry, the use of BAdIs, integration of capacity assignments, or the rolling up of the values of the assigned portfolio items. You can roll up financial data by executing the program /RPM/ FICO_INT_PLANNING. You can start the program using transaction SA38. Depending on the execution options, you can perform the rollup, integration, or planning of financial data. The data of views that are filled using the FI/CO integration can also be used to derive the values of the Plan Costs Total, Plan Costs YTD, Actual Costs Total, Actual Costs YTD, Total Budget, and Annual Budget fields in the detail screen of portfolio items. To do so, you are required to assign an Amount Type to the relevant views, which the system then uses to determine whether the view values are to be used to determine the plan costs, actual costs, or budget values. Definition of Financial Views Figure 61: Definition of Financial Views Lesson: Configuring Financial Planning © Copyright. All rights reserved. 107
116.
7/26/2020 SAP e-book 1/1 Portfolio

types allows you to control which financial views and financial categories are to be available for various portfolios. In the Customizing activity Define Financial Capacity Settings for Portfolio Types , you assign the relevant financial views and financial categories to the individual portfolio types. You also define the financial chart groups dependent on the portfolio type to evaluate financial data graphically. A financial chart group is only a grouping of one or more financial views, which are to be displayed within a chart. You can choose not to display all combinations of financial views and financial categories in financial planning. In the Customizing activity Define Financial and Capacity View for Front-End Configuration , you can define which combinations are allowed. LESSON SUMMARY You should now be able to: ● Configure financial planning Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 108
117.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 3 Configuring Financial Planning by Integration LESSON OVERVIEW This lesson shows the integration options provided by financial planning. Business Example You have already entered cost forecasts for buckets and for items from your portfolio in SAP Portfolio and Project Management. You have also added new categories, groups, and views to financial planning. Now, you want to familiarize yourself with the integration options provided by financial planning. For this reason, you require the following knowledge: ● An understanding of the integration options of financial planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline the configuration of financial planning by integration SAP FI/CO Integration to Financial Planning Figure 62: Mapping of Cost Elements to Financial Views and Financial Groups In addition to manually entering financial data (for forecasting purposes or within strategic planning in the financial planning of PPM), you can also integrate data from linked FI/CO systems in the financial planning of portfolio items. You can use your own implementation of BAdI/RPM/FIN_CAP_PLAN for this purpose (the relevant view must then provide the process other). Alternatively, you can use the FI/CO integration of PPM (the view must contain integration as a process). The logic for managing accounting data differs in FI/CO systems and in PPM. Therefore, you must also make an appropriate mapping of the accounting data from the FI/CO and the © Copyright. All rights reserved. 109
118.
7/26/2020 SAP e-book 1/1 financial
data in PPM. In the Customizing activity Define Financial Planning Settings, you define which data from linked FI/CO systems are to be used to fill views with the integration process. You assign cost elements to the relevant combinations of financial views, financial categories, and financial groups depending on the relevant FI/CO system. If necessary, a cost element is determined by the value type (under which the accounting data is saved in PPM), the controlling area, a cost element interval, and the CO version. In PPM the following value types are available: ● Planned costs ● Actual costs ● Commitment ● Budgets ● Actual time ● Planned time ● Revenue actual ● Revenue planned As an alternative to the mapping of cost elements, you can map cost center and activity types to views, categories, and groups. Hint: You cannot use the standard value types of PPM to differentiate between commitments due to purchase requisitions and purchase orders in financial planning. Capacity Planning Integration to Financial Planning Capacity planning for a portfolio item can be used as the basis for calculating financial planning data. This does not result in additional work for end users. However, in the configuration of PPM, you must establish an assignment between a financial view (including category and group) and a capacity view (including category and group). A rate is determined from the cost/revenue rate from Project Management, which must also be assigned. You define the corresponding entries in the Customizing activity Define Financial Planning Settings. There, maintain the entry Map Fin./Capacity Entities to Project Management Rate . Hint: You can assign multiple capacity views/categories/groups to a single financial view/category/group. You can integrate and aggregate capacity planning to financial planning. Project Management Integration to Financial Planning The integration of Project Management projects offers another option for determining financial data based on already maintained data. It enables you to derive the financial data of an item from the role demands or the resources assigned to the roles. The corresponding rate Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 110
119.
7/26/2020 SAP e-book 1/1 is
derived from the cost/revenue rate of that role. The prerequisite is that there is a portfolio project with project roles that is associated with the item. The link to the respective financial view (including category and group) takes place using the Function field of the respective project role. Valid entries for the Function field are required to be prepared in the configuration of PPM. Hint: You can integrate and aggregate role demands or resource assignments to a single financial view/category/group. You define the corresponding entries in the Customizing activity Define Financial Planning Setting. There, maintain the entry Map Financial Views to Project Management Role Function . At this point, you decided whether role demands or assigned resources are the basis for integration. LESSON SUMMARY You should now be able to: ● Outline the configuration of financial planning by integration Lesson: Configuring Financial Planning by Integration © Copyright. All rights reserved. 111
120.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 4 Planning Capacity LESSON OVERVIEW This lesson shows you how to perform capacity planning for portfolio buckets and portfolio items in SAP Portfolio and Project Management. Business Example You want to enter the first estimates of the required capacities for the individual IT projects of your department in SAP Portfolio and Project Management. Later, you want to compare your estimates with the detailed resource planning and the actual resources that are required for the individual projects. For this reason, you require the following knowledge: ● An understanding of how to perform capacity planning for items ● An understanding of how to perform capacity planning for buckets ● An understanding of capacity categories, groups, and views LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline capacity planning ● Enter capacity planning values manually ● Check the capacity planning rollup ● Outline capacity planning by integration © Copyright. All rights reserved. 112
121.
7/26/2020 SAP e-book 1/1 Capacity
Planning Figure 63: Capacity Planning Overview In PPM, you face a number of constraints. You must complete items and projects on time and within budget. However, capacity demand and resource allocation have an impact on your item. Capacity planning can be crucial for an item when resources are limited. Based on capacity data, you may decide which product of your portfolio item is required to be updated, which project is required to be terminated, or in which product you want to invest. In PPM you can enter, aggregate, and analyze capacity data at different levels. For example, you can plan capacity demand for items, for initiatives, and for buckets. You can either enter capacity data manually, roll up data to superior objects, or use integration of subordinate objects like portfolio projects. Capacity data is planned along a timeline. You can use a period breakdown for capacity planning. Capacity data is planned with respect to a certain unit. However, you can convert units in portfolio management. The capacity planning process in PPM is not just about planning demand, but also about forecasted values, assigned resources, and actual values. Therefore, you can compare planned data with actual data. Lesson: Planning Capacity © Copyright. All rights reserved. 113
122.
7/26/2020 SAP e-book 1/1 Capacity
Categories, Groups, and Views Figure 64: Concept of Capacity Categories, Groups, and Views Capacity planning in PPM is based on categories, groups, and views, which are predefined. Examples of Categories, Groups, and Views ● Category Management, development ● Group ABAP developer, Java developer ● View Demand, allocated As a PPM administrator, you can set up your own categories for your company. You can subdivide your own categories in your own groups. Finally, you set up views as per your company's needs. As a portfolio manager, you can start planning from different points of view. The figure, Concept of Capacity Categories, Groups, and Views, displays capacity planning with three different hierarchies. During capacity planning, you can switch between these hierarchies. Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 114
123.
7/26/2020 SAP e-book 1/1 Manual

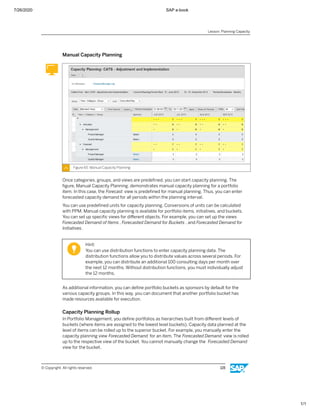

Capacity Planning Figure 65: Manual Capacity Planning Once categories, groups, and views are predefined, you can start capacity planning. The figure, Manual Capacity Planning, demonstrates manual capacity planning for a portfolio item. In this case, the Forecast view is predefined for manual planning. Thus, you can enter forecasted capacity demand for all periods within the planning interval. You can use predefined units for capacity planning. Conversions of units can be calculated with PPM. Manual capacity planning is available for portfolio items, initiatives, and buckets. You can set up specific views for different objects. For example, you can set up the views Forecasted Demand of Items , Forecasted Demand for Buckets , and Forecasted Demand for Initiatives. Hint: You can use distribution functions to enter capacity planning data. The distribution functions allow you to distribute values across several periods. For example, you can distribute an additional 100 consulting days per month over the next 12 months. Without distribution functions, you must individually adjust the 12 months. As additional information, you can define portfolio buckets as sponsors by default for the various capacity groups. In this way, you can document that another portfolio bucket has made resources available for execution. Capacity Planning Rollup In Portfolio Management, you define portfolios as hierarchies built from different levels of buckets (where items are assigned to the lowest level buckets). Capacity data planned at the level of items can be rolled up to the superior bucket. For example, you manually enter the capacity planning view Forecasted Demand for an item. The Forecasted Demand view is rolled up to the respective view of the bucket. You cannot manually change the Forecasted Demand view for the bucket. Lesson: Planning Capacity © Copyright. All rights reserved. 115
124.
7/26/2020 SAP e-book 1/1 A
view is either rolled up to the bucket or maintained manually. The rollup of planning data is possible from an item to the superior bucket. The rollup is also possible from a bucket to a superior bucket. If you make use of initiatives, a rollup is possible from an initiative item to a superior initiative, and to a superior bucket. Details of the rollup process are set up in the configuration of views. Capacity Planning by Integration Figure 66: Capacity Planning by Integration In PPM, capacity planning data is entered manually, is rolled up, or is calculated by integration of capacity planning of subordinate objects (for example, a portfolio project that is assigned to a portfolio item). The demand planning based on the roles of a project can be integrated with a capacity planning view of the superior item. Integration of capacity planning is set up in the configuration of views for capacity planning in PPM. However, integration can be enabled for items only. You cannot use integration for buckets or for initiatives. In addition to roles and allocation of assigned projects, you can integrate cost planning data, budget, actual cost, and commitments for a number of SAP ERP cost objects. The figure, Capacity Planning by Integration, shows typical objects assigned to portfolio items. For example, based on confirmations of working hours of an assigned internal order, you can calculate the Actual view in the capacity planning of an item. Note: There is no standard delivery or configuration for integration of capacity planning. LESSON SUMMARY You should now be able to: ● Outline capacity planning ● Enter capacity planning values manually ● Check the capacity planning rollup ● Outline capacity planning by integration Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 116
125.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 5 Configuring Capacity Planning LESSON OVERVIEW The lesson shows the Customizing settings that are required for capacity planning with SAP Portfolio and Project Management. Business Example You have used capacity planning for items to enter planned and actual values manually. Starting next year, you are asked to analyze resource assignments as well. Resources are assigned to the portfolio project. You want to maintain the configuration settings for capacity planning in Customizing for SAP Portfolio and Project Management. For this reason, you require the following knowledge: ● An understanding of the required Customizing settings for capacity planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure capacity planning Capacity Planning Configuration Figure 67: Capacity Planning Customizing To use capacity planning, you must configure various settings in Customizing for PPM. The figure, Capacity Planning Customizing, provides an overview of the required Customizing activities. © Copyright. All rights reserved. 117
126.
7/26/2020 SAP e-book 1/1 You
define the period breakdown and the time unit required for capacity planning in individual portfolio buckets, items, and initiatives. The time units and period types are defined in the Customizing activities Define Capacity Units and Define Period Types . In the Customizing activity Define Financial and Capacity Categories, first create capacity categories such as management or development. A category consists of an identification and a text. You can create several capacity groups for each category. Project management and quality management are examples of capacity groups for the management category. Every group has an identification, a text, and a distribution type that defines if calendar days or working days are used for the distribution. A capacity group does not exist by itself but is clearly assigned to a superior category. You create capacity views in the Customizing activity Define Financial and Capacity Views. In addition to the identification and the text, you define whether each capacity view can be used for portfolio items, portfolio buckets, initiatives and/or items of initiatives. Depending on the respective object, you also decide whether the view can be filled manually, or is integrated automatically for FI/CO objects, or is determined using a BAdI, or is rolled up from subordinate objects. The manual entry of capacity data for portfolio buckets is useful if you want to make a rough estimate of the required capacities. You can compare this with the total of the demands of assigned items. Direct integration with resource planning or actual times is only available for views at the portfolio item level. Definition of Capacity Views Figure 68: Definition of Capacity Views The portfolio type controls which capacity categories and capacity views are available for a portfolio. You can assign the relevant capacity categories and capacity views to each portfolio type in the Customizing activity Define Financial Capacity Settings for Portfolio Types . You can create chart groups in this Customizing activity to graphically evaluate the capacity data. If you want to evaluate the views Forecast Demands , Planned Demands, and Actual Capacity Demands together in one chart, create a chart group and assign these three views. If you also want to evaluate the planned demands only, create a second chart group to which you assign only one view. In the capacity planning chart, you can then choose which capacity categories and chart groups are displayed, and switch between the chart groups. Unit 5: Financial and Capacity Planning © Copyright. All rights reserved. 118
127.
7/26/2020 SAP e-book 1/1 If
necessary, not all combinations of capacity categories and capacity views that you assigned to the portfolio type in Customizing are displayed for the capacity planning. In the Customizing activity Define Financial and Capacity View for Front-End Configuration , you can define which combinations of capacity categories and capacity views are valid. The capacity views and capacity categories that are defined in Customizing for PPM (depending on the portfolio type) must still be created for the buckets, items, and initiatives of a portfolio. That is, they must be activated. You do this by using the program /RPM/ PLAN_INT_PREP, which can be executed in the PPM core system using transaction SA38. You can select individual or several items in the selection screen of the program. You can also use a bucket or a complete portfolio as the selection criteria. If necessary, you can first execute a test run before you actually trigger the creation. LESSON SUMMARY You should now be able to: ● Configure capacity planning Lesson: Configuring Capacity Planning © Copyright. All rights reserved. 119
128.
7/26/2020 SAP e-book 1/1 Unit
5 Lesson 6 Configuring Capacity Planning by Integration LESSON OVERVIEW This lesson shows the Customizing settings that are required for capacity planning by integration with SAP Portfolio and Project Management. Business Example You have used capacity planning for items to enter planned and actual values manually. Beginning next year, you are asked to analyze resource assignments as well. Resources are assigned to the portfolio project. You want to maintain the configuration settings for capacity planning and integration in Customizing for SAP Portfolio and Project Management. For this reason, you require the following knowledge: ● An understanding of the integration options of capacity planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline the configuration of capacity planning by integration Capacity Planning by Integration Figure 69: Settings for the Integration of Capacity Data You can plan capacity manually in an early stage of portfolio and project management. However, as soon as more detailed resource planning data or actual data is available, it is integrated in capacity planning so that it can be evaluated with the data that was entered manually. © Copyright. All rights reserved. 120
129.
7/26/2020 SAP e-book 1/1 Define
capacity views for the relevant planning data and actual data, which provide for the integration of the data. You must define the integration of the data. You do this by using a customer-defined implementation of the Business Add-In (BAdI), that is /RPM/ FIN_CAP_PLAN, or by using the standard integration options. You can specify the options in the Customizing activity PPM→ Portfolio Management→ Base System Interfaces → Capacity Planning Settings→ Define Capacity Planning Settings. There are two standard integration options available for capacity planning at the portfolio item level. In the first option, you have the integration of resource planning data from assigned portfolio projects. In the second option, you have the derivation of capacity demands from actual or planned times entered in FI/CO systems. Integration in Detail For integration in resource planning, an item must be linked to a portfolio project with roles reflecting the demand. The roles can be staffed with resources. In Project Management, you can either define the roles and their staffing manually or upload them from other project management systems, such as SAP Project System or Microsoft Project. You can assign a Role Function to each role and set your own definition for the Role Function in Customizing for Project Management. Project management, development, and quality inspection are some of the examples of Role Function. To integrate role demands and role staffing in capacity planning, define assignments between the Role Function and combinations of capacity views, capacity categories, and capacity groups. You can assign role demands and role staffing separately. Using the program /RPM/ CAP_PLAN_INT, the resource planning data in the capacity planning data is integrated with these assignments. Using the transaction SA38, you can execute this program in the PPM core system. To integrate actual time and planned time in capacity planning, you are required to set up the FI/CO interface for PPM. For example, to integrate the actual time posted to an internal order in the FI/CO system to the capacity planning of an item, link the internal order and the portfolio item, and execute the FI/CO integration. Then, start the program /RPM/ FICO_INT_PLANNING in the PPM core system. This program now transfers the actual time and planned time of the internal order to the capacity planning of the item. All the integration options introduced were designed for transferring the data of subordinate objects to higher level ones. However, you can pass manually planned capacity data of a portfolio item to a role of the associated portfolio project. This means capacity planning data is transferred to an existing project role or to one that is to be created automatically. The operation can be performed only once for each capacity view and group. Constant updates are not possible. LESSON SUMMARY You should now be able to: ● Outline the configuration of capacity planning by integration Lesson: Configuring Capacity Planning by Integration © Copyright. All rights reserved. 121
130.
7/26/2020 SAP e-book 1/1 Unit
5 Learning Assessment 1. Financial planning in SAP Portfolio and Project and Project Management (PPM) is based on which of the following? Choose the correct answers. X A Categories X B Buckets X C Groups X D Versions X E Views 2. For which of the following objects is manual financial planning available? Choose the correct answers. X A Financial groups X B Portfolio items X C Portfolio initiatives X D Portfolio buckets X E Financial categories 3. Financial data planned at the level of items can be rolled up to the superior bucket. Determine whether this statement is true or false. X True X False 4. Financial planning by integration can be enabled for buckets but not for items. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 122
131.
7/26/2020 SAP e-book 1/1 5.
While configuring financial planning, at which of the following levels can you define financial views? Choose the correct answers. X A Portfolio item X B Portfolio bucket X C Financial group X D Financial category X E Initiative item 6. What are the integration options of financial planning? Choose the correct answers. X A SAP FI/CO Integration X B Capacity Planning Integration X C Project Management Integration X D Microsoft Project Integration 7. For which of the following is manual capacity planning available? Choose the correct answers. X A Portfolio items X B Portfolio initiatives X C Portfolio buckets X D Portfolio snapshots 8. You can use integration for capacity planning of buckets and initiatives. Determine whether this statement is true or false. X True X False Unit 5: Learning Assessment © Copyright. All rights reserved. 123
132.
7/26/2020 SAP e-book 1/1 9.
Which of the following controls and to which capacity categories and capacity views are available for a portfolio? Choose the correct answer. X A Portfolio type X B Portfolio bucket X C Capacity planning X D Initiative item 10. You have to define roles and their staffing manually in Project Management. You cannot upload them from other project management systems. Determine whether this statement is true or false. X True X False Unit 5: Learning Assessment © Copyright. All rights reserved. 124
133.
7/26/2020 SAP e-book 1/1 Unit
5 Learning Assessment - Answers 1. Financial planning in SAP Portfolio and Project and Project Management (PPM) is based on which of the following? Choose the correct answers. X A Categories X B Buckets X C Groups X D Versions X E Views Correct. The Financial planning in PPM is based on Categories, Groups, and Views. 2. For which of the following objects is manual financial planning available? Choose the correct answers. X A Financial groups X B Portfolio items X C Portfolio initiatives X D Portfolio buckets X E Financial categories Correct. Manual financial planning is available for portfolio items, initiatives, and buckets. 3. Financial data planned at the level of items can be rolled up to the superior bucket. Determine whether this statement is true or false. X True X False Correct. Financial data planned at the level of items can be rolled up to the superior bucket. © Copyright. All rights reserved. 125
134.
7/26/2020 SAP e-book 1/1 4.
Financial planning by integration can be enabled for buckets but not for items. Determine whether this statement is true or false. X True X False Correct. Financial planning by integration can be enabled for items. 5. While configuring financial planning, at which of the following levels can you define financial views? Choose the correct answers. X A Portfolio item X B Portfolio bucket X C Financial group X D Financial category X E Initiative item Correct. While configuring financial planning, you can define whether the financial view is to be available at the portfolio item level, initiative level, initiative item level, and/or at the portfolio bucket level. 6. What are the integration options of financial planning? Choose the correct answers. X A SAP FI/CO Integration X B Capacity Planning Integration X C Project Management Integration X D Microsoft Project Integration Correct. Financial planning provides SAP FI/CO Integration, Capacity Planning Integration, and Project Management Integration options. Unit 5: Learning Assessment - Answers © Copyright. All rights reserved. 126
135.
7/26/2020 SAP e-book 1/1 7.
For which of the following is manual capacity planning available? Choose the correct answers. X A Portfolio items X B Portfolio initiatives X C Portfolio buckets X D Portfolio snapshots Correct. Manual capacity planning is available for portfolio items, initiatives, and buckets. 8. You can use integration for capacity planning of buckets and initiatives. Determine whether this statement is true or false. X True X False Correct. Integration of capacity planning can be enabled for items only. You cannot use integration for buckets or for initiatives. 9. Which of the following controls and to which capacity categories and capacity views are available for a portfolio? Choose the correct answer. X A Portfolio type X B Portfolio bucket X C Capacity planning X D Initiative item Correct. The portfolio type controls which capacity categories and capacity views are available for a portfolio. 10. You have to define roles and their staffing manually in Project Management. You cannot upload them from other project management systems. Determine whether this statement is true or false. X True X False Correct. In Project Management, you can either define the roles and their staffing manually or upload them from other project management systems, such as SAP Project System or Microsoft Project. Unit 5: Learning Assessment - Answers © Copyright. All rights reserved. 127
136.
7/26/2020 SAP e-book 1/1 UNIT
6 Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) Lesson 1 Using Project Management 130 Lesson 2 Project Structures 144 Lesson 3 Project Time Scheduling 158 Lesson 4 Resource Planning 164 Lesson 5 Cost Planning and Cost Integration 180 Lesson 6 Project Execution 190 Lesson 7 Project Evaluation 204 Lesson 8 Project Versions 215 UNIT OBJECTIVES ● Outlining SAP S/4HANA Project Management ● Project Structure ● Configuration of project structures ● Document Management © Copyright. All rights reserved. 128
137.
7/26/2020 SAP e-book 1/1 ●
Authorizations in SAP S/4HANA Project Management ● Scheduling of Dates ● Outline roles in Project Management ● Create roles in Project Management ● Outline the configuration of a project role type ● Outline a business partner ● Create a business partner in SAP PPM ● Check a business partner in SAP S/4HANA ● Create a resource pool ● Staff roles ● Outline extended staffing processes ● Scheduling and Resource Management ● Cost Planning ● Costing configuration ● Status management and project release ● Confirmation of activities in projects ● Approval process of phases in projects ● Reporting in SAP S/4HANA Project Management ● Project snapshots and simulation versions © Copyright. All rights reserved. 129
138.
7/26/2020 SAP e-book 1/1 Unit
6 Lesson 1 Using Project Management LESSON OVERVIEW This lesson gives you an overview of the functions for structuring, planning, and executing projects by using Project Management. Business Example In your company, you use various tools for managing your projects. For IT and development projects, you plan to use Project Management. Therefore, you want to get an overview of the functions offered by Project Management as a project management tool. For this reason, you require the following knowledge: ● An understanding of the structure elements of Project Management ● An understanding of the various possibilities for document management with Project Management ● An understanding of the planning functions of Project Management LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outlining SAP S/4HANA Project Management ● Project Structure Project Management Project Management as part of SAP Portfolio and Project Management is a a cross-industry tool which is used to plan and monitor development and consulting projects. Complex development and consulting projects place high demands on a business. To meet these demands, we require planning solutions that support progressive project management methods. These planning solutions reduce the project duration and improve quality. It is vital to introduce tools that are easy to use and implement and enable project participants to work together. Prerequisites for Successful Projects ● Precisely defined deliverables to avoid misunderstandings and late changes occurring during the development of a project ● Precisely defined roles to give employees responsibility, and make them more competent ● The commitment of all parties involved ensures completion of tasks and agreement of goals ● Collaboration with partners © Copyright. All rights reserved. 130
139.
7/26/2020 SAP e-book 1/1 ●
Using a method with clear transitions between phases, such as templates, quality gates, handover meetings, and milestones Projects can be extensive and complex. The success of a project depends on various factors, such as availability of resources, on-time delivery performance, or budget requirements. The basic rules to ensure a successful project are as follows: ● Specifications must be precise and you should have a written copy of them. ● Roles and activities in the project must be defined. ● The people involved in the project must feel responsible for their role in it. ● The people involved must be able to work with each other without problems. Project management is suited to consulting, development, and IT projects. The aim of project management is to enable the development of better products. The development of better products means that the development of the products is cheaper, quicker, and the end result is a better quality product The following processes require improvement in order to develop better products: ● Development:This process can be improved by focusing on planning and avoiding errors in early phases. ● Project Planning:This process can be improved by focusing on, and constantly checking, the processes of the project. This will allow you to identify any deviations from the plan early on, and reduce costs that might occur due to deviations. The phase-oriented approach of project management supports this procedure. ● Monitoring and documentation processes: This process can be improved in product development. ● Collaboration: Collaboration is the backbone of teamwork, whether it is a project team trying to coordinate employee activities at different locations, or an original equipment manufacturer (OEM) aiming to accelerate and improve product development in cooperation with supply chain partners. Seamless collaboration between teams is essential for businesses, particularly in the area of product development. Therefore, successful collaboration requires an environment in which teams can easily exchange information. In the past, quick conversations or regular meetings were suitable for exchanging information but they are now insufficient. Currently, teams collaborate across various locations. These teams consist of resources from various internal or external partners. Information has become more comprehensive. It ranges from simple memos to complex drawings. E-mails, phone calls, web meetings, and so on have increased the range of communication channels. To be successful, companies need powerful solutions that allow them to employ sophisticated project management methods that drive speed and quality. SAP Portfolio and Project Management helps you standardize and improve project management execution and reduce associated administrative and system costs. It provides reliable project management functions that can be deployed independently or integrated into your back-end systems (such as HR and Financials). Project Management is ideal for managing phase-based projects. It delivers highly specialized support for product development, professional services, agile development, IT, and other types of projects. It supports structuring, scheduling, visualization, operative planning, and execution. Lesson: Using Project Management © Copyright. All rights reserved. 131
140.
7/26/2020 SAP e-book 1/1 The
Project Management concept is suitable for IT development, consulting, and service projects. You can enter names and more detailed descriptions of objects in Project Management in several languages. Project Management can be used with the SAP NetWeaver Business Client or in the Fiori Launchpad. Project Management Basic Functions ● Structuring of projects based on phases, tasks, and checklists ● Various options for document management ● Authorization concept based on access control lists ● Gantt chart, and bottom-up or top-down scheduling ● Resource planning based on roles and business partners ● Confirmations and integration with CATS ● Approval processes for phases ● Evaluations and status reports ● Alert management ● Integration option with FI/CO and SAP PS ● Multi-project management options and multi-project monitor Figure 70: Project Elements in SAP Project Management The figure, Project elements in SAP Project Management , shows individual elements of a project in SAP Project Management. The structure of projects in SAP Project Management is based on phases. Each phase is processed after the other and there are fixed transitions Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 132
141.

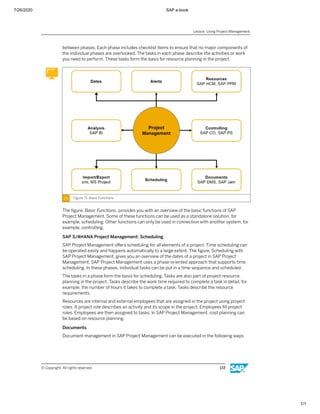

7/26/2020 SAP e-book 1/1 between
phases. Each phase includes checklist items to ensure that no major components of the individual phases are overlooked. The tasks in each phase describe the activities or work you need to perform. These tasks form the basis for resource planning in the project. Figure 71: Basic Functions The figure, Basic Functions, provides you with an overview of the basic functions of SAP Project Management. Some of these functions can be used as a standalone solution, for example, scheduling. Other functions can only be used in connection with another system, for example, controlling. SAP S/4HANA Project Management: Scheduling SAP Project Management offers scheduling for all elements of a project. Time scheduling can be operated easily and happens automatically to a large extent. The figure, Scheduling with SAP Project Management, gives you an overview of the dates of a project in SAP Project Management. SAP Project Management uses a phase-oriented approach that supports time scheduling. In these phases, individual tasks can be put in a time sequence and scheduled. The tasks in a phase form the basis for scheduling. Tasks are also part of project resource planning in the project. Tasks describe the work time required to complete a task in detail, for example, the number of hours it takes to complete a task. Tasks describe the resource requirements. Resources are internal and external employees that are assigned in the project using project roles. A project role describes an activity and its scope in the project. Employees fill project roles. Employees are then assigned to tasks. In SAP Project Management, cost planning can be based on resource planning. Documents Document management in SAP Project Management can be executed in the following ways: Lesson: Using Project Management © Copyright. All rights reserved. 133
142.
7/26/2020 SAP e-book 1/1 ●
Document management within SAP Project Management ● Integration with SAP Document Management System (SAP DMS) ● SAP Jam as a web-based collaboration platform in virtual teams During the course of a project, many documents are created and edited. These documents must be centrally accessible by authorized users. SAP Project Management offers several document management options, for example, an integrated document management system. It also provides the option of integrating the document management system of an SAP S/ 4HANA system or an external document management system. Integration Aspects of SAP S/4HANA Project Management Although SAP Project Management can be used as a standalone system, in practice, it is linked to other systems. For instance, you can set up integration with various SAP systems and products. In each case, the integration that needs to be used depends on the business processes, and on the system that is already being used. The figure, Options for integrating SAP S/4HANA Project Management , displays various integrations. Figure 72: Options for integrating SAP S/4HANA Project Management SAP systems offer the following project management functions: ● Other SAP S/4HANA modules: Integration in Controlling, Project System, Document Management, and links to various objects, such as purchase and maintenance orders ● SAP Human Capital Management (SAP HCM): Integration of human resources master records, organizational management, and qualification orders. ● SAP Jam: Offers simplified exchange of documents with partners ● SAP Business Intelligence (SAP BI): Offers detailed evaluations of projects. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 134
143.

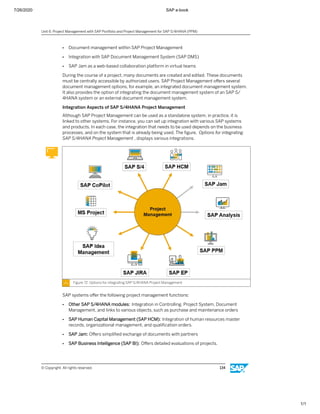

7/26/2020 SAP e-book 1/1 ●
SAP Portfolio and Project Management (SAP PPM): Offers cross-project resource planning and portfolio management for strategic project management. SAP Innovation Management The success of a company increasingly depends on its capability to come up with innovative products, services or business models. On the one hand, this capability requires a culture of creativity and innovation, where employees share and discuss their ideas both with colleagues and with management. On the other hand, these ideas need to be systematically managed, which usually means that they are evaluated and filtered according to a predefined process in order to extract the most promising ones. SAP Innovation Management helps you foster a culture of innovation by offering a platform where employees can easily put down their own ideas and views, and discuss the ideas of others. At the same time, SAP Innovation Management enables you to run campaigns to systematically collect ideas and manage the ideas according to a predefined and adaptable innovation process. The innovation process is made up of number of phases; ideas are guided by idea coaches, evaluations are carried out by experts, conceptual work is carried out within innovation projects, concluding with inclusion into products and successful market introduction. Figure 73: SAP Innovation Management SAP Innovation Management is made up of the following parts: ● Idea Community: This is a platform for all employees to create, share, and discuss their ideas. It is a place for employees to discuss their ideas and to participate in idea campaigns, browse through ideas, and comment on or vote on ideas. If they want to share their own ideas, employees can submit them. Notifications keep them informed about how their ideas progress along the innovation process. The idea community is also the place where subject matter experts evaluate ideas. ● Innovation Office: This is a platform for all users of SAP Innovation Management. The innovation office is a kind of back office for specialists working professionally with ideas and campaigns. Here, campaign managers set up and monitor campaigns, idea coaches process the ideas of the campaign, innovation managers administer users, configure phases and evaluation methods for campaigns and more. Lesson: Using Project Management © Copyright. All rights reserved. 135
144.
7/26/2020 SAP e-book 1/1 ●
Mobile Web Application: This is a platform for users of SAP Innovation Management who want to user their mobile devices to quickly draft an idea, check their notifications, or explore idea lists and campaigns when on the move. SAP PPM contains an object link for SAP Innovation Management. This is the preferred solution to explore, evaluate, and manage ideas in the innovation process. Figure 74: Object Link for Innovation Management in SAP Project and Portfolio Management You can link ideas from SAP HANA extended application services based on the SAP Innovation Management application, to tasks and projects. You can retrieve idea information, such as Idea ID and Name, Submitter, Coach, Campaign, Phase, and Status in the object details. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 136
145.
7/26/2020 SAP e-book 1/1 Figure

75: Navigation from SAP PPM to SAP Innovation Management The forward navigation from SAP PPM to SAP Innovation Management supports cross- application Product Lifecycle Management (PLM) processes. The Innovation Management Idea in turn, retrieves information from linked objects, such as dates, responsible role for a task, and the active decision point of an item. You can navigate to the linked idea through Innovation Community and Innovation Office. Both tools display the linked idea, but in different contexts. The creation of a link to an idea follows the general steps for object links. It is possible to search for ideas using the Idea ID and Name, Campaign, or the Completed flag. From the hit list of ideas, which meet the criteria you can select multiple ideas to create multiple object links. Project Elements SAP Project Management is a tool that supports development, consulting, and IT projects. Project resource planning is particularly relevant in consulting and IT projects. The success of development projects depends on the use of a suitable implementation method. Different industries have different approaches for implementation methods, for example, Agile Project Management in the IT industry. Other industries have also developed methods for simplifying processes and reducing nonconformity costs. You can use the following project elements to support your method: ● Project definition ● Phase ● Checklist ● Checklist item ● Task ● Subtask ● Project role Lesson: Using Project Management © Copyright. All rights reserved. 137
146.
7/26/2020 SAP e-book 1/1 Project
roles are useful in project resource planning. Other project objects are used for structuring the project. The figure, Project Elements, shows the individual elements and their dependencies. These dependencies can be hierarchical or specified by relationships for scheduling. Figure 76: Elements of Project Management The project element at the highest level of the hierarchy is the project definition. A project definition contains the general data for a project in Project Management. The project definition contains the name and identification of the project as well as details about the planned start and finish date. The project definition also contains the assignment to an organizational unit of your company. The first step to create a project is defining a project. In SAP Project Management, each project has a project definition. It contains general information about the project. The figure, Project Definition, shows the screen for editing the basic data of a project definition. In the navigation area of SAP Project Management, the project definition is displayed by a triangle. You can identify the project definition by a 24-digit alphanumeric text. You can also describe the project definition in 40-digit alphanumeric text. The name of the project is language-dependent. You can create German and English descriptions; if the short description is insufficient, you can create a language-dependent long text description. Hint: In SAP S/4HANA Project Management, the descriptions and names of objects are language-dependent. You can switch the language during the processing of your project. This language is defined as the text language in SAP Project Management. Text languages are defined in Customizing. You do not need to log off and log back on to change the text language in the application. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 138
147.

7/26/2020 SAP e-book 1/1 Note: You
can copy existing projects by choosing Copy Project. Using the Basic Data tab page, you can define a responsible role for the overall responsibility for the project. The time frame for the whole project is defined on the Dates and Work tab page in the project definition. On the Additional Data tab page, you can specify the sold-to party, customer, and assigned organizational units for the project definition. You do not plan the required capacity for the project definition. Instead, tasks and project roles are used to plan the required capacity. The following Customizing profiles are directly assigned to the project definition: ● Project reason: This profile is relevant for evaluations. ● Priority: This profile is relevant for evaluations. ● Project type: This profile a central profile for controlling the project. Define a project type at the latest release of the project. Project types are defined in Customizing for Project Management and determine the properties of projects in Project Management as far as possible. Authorizations that you grant at the project definition level are automatically passed on to all subordinate objects in the project. However, if necessary, you can adjust, enhance, or even revoke them at the project definition. Hint: Before you release a project, you must specify a project type. You cannot change the project type after the project is released. Phases After the project definition, phases are the second hierarchy level of a project in SAP Project Management. You can use phases to structure the project from a time aspect. Phases are sections of a project that are completed in a certain time. Start and finish dates are calculated by scheduling or by manually specified fixed dates. Each phase can have a predecessor and a successor. Time overlaps of phases lead to schedule conflicts with the corresponding warning messages. Using approval processes, you can make the completion of a phase dependent on the approval of various decision makers. In this way, you can implement quality gates between the various phases. Executing a phase begins with its release and ends with an approval process. You can configure SAP Project Management to ensure that a phase begins only when the previous phase is completed. The figure Master Data Maintenance for a Phase illustrates master data maintenance for a phase. In the navigation area, arrows pointing to the right represent the phases. You can identify phases by 24-character, alpha-numerical text. However, as with the project definition, you can name a phase using a 40-character text and you can use a long text to describe it. On the Basic Data screen of a phase, you specify the description, the predecessor phase, the responsible role, and change the status. The phase type is stored on the Basic Data screen. The phase type is a profile in Customizing that describes the approval process of a phase. Lesson: Using Project Management © Copyright. All rights reserved. 139
148.
7/26/2020 SAP e-book 1/1 On
the Additional Data tab page, you can maintain the Grouping and Search fields. In these fields, you can enter up to 40 characters of text. You can use both fields as additional criteria when you search for objects. Hint: You can enter short comments on the Notes tab page for phases and other project elements. The comments are displayed with the time and the person who entered them. This creates a type of bulletin board for the respective project element. You can use further assignments to expand the phases, for example, you can assign documents, create collaborations, and establish object links to SAPS/4HANA and external objects. Checklists Checklists in Project Management are lists with items that are to be completed in the course of the project or in individual phases. . Checklists ensure that important aspects of a project or a phase are completed. Checklists are assigned to phases and are located in the third hierarchy level of a project. You can assign several checklists to a phase. A checklist consists of a collection of checklist items. Checklist items describe important aspects of a phase. The checklist only contains a small amount of data. The basic data includes the name, description, status, priority, and a responsible role. You can flag items of a checklist within a phase as relevant for approval or mandatory. In this way, you can ensure that these items must be completed before the phase can be approved or completed. Hint: You can also assign checklists directly to the project definition by setting an indicator in the project type. Checklists are usually assigned to phases or tasks, but an assignment to the project definition in form of an issue list is possible as well. The figure Master Data Maintenance for a Checklist shows the data that must be maintained for a checklist. In the navigation area, a checklist has a square symbol. You can identify the checklist by a 24-digit alphanumeric text. Alternatively, you can name a checklist using 40 characters and you can use a long text to describe it. The text is language-dependent. The checklist type is also maintained on the Basic Data screen; it is a Customizing profile. You need the profile to release the checklist. The checklist type determines if the checklist is an ordinary checklist or an issue list. An issue list describes unplanned items that occur but must be completed in the project. An issue list is assigned in the project definition or in a phase. You can add further objects to checklists and issue lists. For example, you can add assigned documents, assigned collaborations, and object links. You can create a checklist manually or by using a copy template. The copy template is marked as a reference to a checklist template. A checklist reference is resolved during the creation of the checklist reference (all checklist items are included) or later on. At the latest, it is resolved when the status of the checklist reference is changed to Released. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 140
149.

7/26/2020 SAP e-book 1/1 Checklist
Items Checklist items are the items in a checklist. To attain the project goal, the items on the checklist must be completed. People involved in the project check off the checklist items when they are completed. The figure, Checklist Items, is a screenshot of the master data maintenance page for checklist items. In the navigation area, a checklist item has a diamond symbol. You can identify a checklist by a 24-character alphanumeric number. The number is assigned internally and cannot be changed. You can enter a short description and a more detailed description. On the Basic Data tab page, you can enter a sort number for the checklist item. This sort number sorts the sequence of the checklist items in an ascending order in the navigation area. SAP Project Management automatically groups checklist items in steps of ten. You can also adjust the sort number manually. The Basic Data tab page also contains other data, such as a name, description, and responsible role. You can also define a priority and a process on the Basic Data tab page, which are predefined entries in Customizing and used for information purposes. The entries do not have a controlling influence on the project. On the Dates and Work tab page, you can define one date . A checklist item is one item, it does not have any duration. Hint: A process for project management does not have anything to do with SAP Controlling (CO) activity-based costing. On the Additional Data tab page, you can define data that may be crucial for approval or confirmation of the checklist item. If a checklist item must be completed before the phase is closed, select the Mandatory checkbox. Mandatory checklist items must have the Completed status before the phase can have the Closed status. If the checklist item must be completed so the phase it belongs to can be approved, select the Relev. for App. checkbox. The other tab pages for checklist items allow you to assign documents, collaborations, and object links. Tasks Tasks are used to enter and structure the required processing steps and individual activities to carry out when a project is being implemented. You can define the duration and the planned work for each task. Tasks are not only elements of a hierarchy. They can also determine time dependencies. You can use the relationships of tasks to describe the sequence in which the tasks are processed. This way, several tasks can be set up in a network-like structure. By linking tasks to each other with relationships, you can define the order and time sequence of tasks. Task scheduling is based on the relationships of tasks. There is a separate tab page to describe task relationships. You can assign tasks directly to the project definition, phases, or checklist items. Tasks in phases and checklist items can be further subdivided into subtasks. This allows you to map entire task hierarchies in Project Management. In the navigation area, tasks can be identified by a circular symbol. The figure Master Data Maintenance for a Task shows the master data required to maintain a task. On the Basic Data tab page, you can identify a task by a 24-character alphanumeric text. The number is assigned internally and cannot be changed. The Name field provides you with a brief description of the task. In the Description field, you can find a detailed description. Both fields are language-dependent like the other project elements. The sort number determines Lesson: Using Project Management © Copyright. All rights reserved. 141
150.
7/26/2020 SAP e-book 1/1 the
display sequence in the navigation area. Sort Number is a numeric field and can have five digits. You can assign another project to a task. This project is interpreted as a subproject. You can enter the task type on the Basic Data tab page. You can maintain the task type in Customizing. The task type is mostly used for information purposes. However, you can also assign a cost and revenue rate to a task type. During costing, you can use the cost and revenue rate to determine planned costs. Hint: The task type must be specified so that a task can be released. You cannot change a task type after the task is released. On the Additional Data tab page, the Priority and Process fields are defined. You can define the characteristics of both fields in Customizing. These fields are not controlling fields. This tab page also specifies whether a task is mandatory for the completion of a phase, or if it is relevant for approving a phase. In the Costing section, you can define cost and revenue rates and additional data for determining planned costs. The Dates and Work tab page contains information about the duration, constraints, planned work, and the confirmation data for the task. The Confirmation section specifies the actual start and end dates, and the actual and remaining work together with the percentage complete. Hint: If a task corresponds to a milestone in the project, you can select the corresponding checkbox. In the navigation area, milestone tasks differ from standard tasks by an additional small circle. In the graphical display, milestone tasks are displayed as rhombuses without time bars. You can assign documents, collaborations, and object links to SAP ERP objects to tasks. You can also assign the project roles that are involved in the implementation of the task. If necessary, you can describe the qualifications required to carry out the task on a separate tab page. Subtasks Subtasks can be used to detail tasks and to structure the required processing steps when you implement a project. Subtasks are subordinates of a task. Depending on the setting of the project type, you may consider a superior task as a collective task that only calculates the work of the subordinate tasks. Alternatively, the work of the superior task can be interpreted in addition to that of the subordinate tasks. Scheduling-wise, subtasks can have relationships to subtasks belonging to the same task or to subtasks belonging to other tasks. A relationship between subtasks and tasks is possible as well. You can divide subtasks into other subtasks. The configuration of the project type determines if subtasks are allowed to be used in projects. The task hierarchy field determines whether subtasks are used at all, and if they are, how their data is aggregated at the higher level. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 142
151.
7/26/2020 SAP e-book 1/1 The
figure Master data maintenance of subtasks shows the master data required to maintain a subtask. The Basic Data tab page of a subtask is the same as the tab page for a standard task. You see the subordinate hierarchy level of the subtask only in the navigation area. LESSON SUMMARY You should now be able to: ● Outlining SAP S/4HANA Project Management ● Project Structure Lesson: Using Project Management © Copyright. All rights reserved. 143
152.

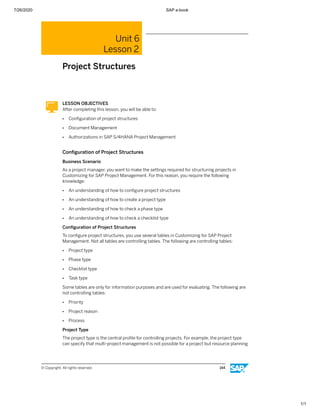

7/26/2020 SAP e-book 1/1 Unit
6 Lesson 2 Project Structures LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configuration of project structures ● Document Management ● Authorizations in SAP S/4HANA Project Management Configuration of Project Structures Business Scenario As a project manager, you want to make the settings required for structuring projects in Customizing for SAP Project Management. For this reason, you require the following knowledge: ● An understanding of how to configure project structures ● An understanding of how to create a project type ● An understanding of how to check a phase type ● An understanding of how to check a checklist type Configuration of Project Structures To configure project structures, you use several tables in Customizing for SAP Project Management. Not all tables are controlling tables. The following are controlling tables: ● Project type ● Phase type ● Checklist type ● Task type Some tables are only for information purposes and are used for evaluating. The following are not controlling tables: ● Priority ● Project reason ● Process Project Type The project type is the central profile for controlling projects. For example, the project type can specify that multi-project management is not possible for a project but resource planning © Copyright. All rights reserved. 144
153.
7/26/2020 SAP e-book 1/1 is
possible. The project type can also specify that confirmations are carried out without a Cross-Application Time Sheet (CATS) at the task level. Figure 77: Configuration of Project Type — Basic Settings In SAP Project Management, you can define the project type on the Basic Data screen of the project definition. To find the project type in Customizing, choose SAP Portfolio and Project Management → Project Management → Structure → Define Project Types . The figure Configuration of project type — basic settings shows the first sections of the project type. The project type determines the project category. It can contain the Consulting project or Development project attributes. Similar to the project category, the Consulting project and Development project attributes are for internal use only. Programs are specific projects in connection with multi-project management, however in most processes, programs are replaced by initiatives of SAP Portfolio Management. Selected basic settings in the project type The project type is subdivided into the following sections: ● Activate Function: - Documents: If this checkbox is selected, SAP Project Management document management becomes available - Versions: If this checkbox is selected, you can create versions for a project with this project type in SAP Project Management - Object Links: If this checkbox is selected, you can use object links in SAP Project Management Lesson: Project Structures © Copyright. All rights reserved. 145
154.
7/26/2020 SAP e-book 1/1 -
SAP document management system (SAP DMS) : If the SAP DMS checkbox is selected, SAP DMS becomes available in SAP Project Management. ● Project Structuring - Phases: If this check box is selected, you can create phases in SAP Project Management. - Tsks/Chckl.f.ProjDef .: If this checkbox is selected, you can create tasks and checklists directly under the project definition in SAP Project Management - Checklists: If this checkbox is selected, you can use checklists in SAP Project Management - Tasks : If this checkbox is selected, you can create tasks in SAP Project Management. - Subprojects: If this checkbox is selected, you can link tasks with a subproject in SAP Project Management (multi-project management) - Mirrored Tasks : If this checkbox is selected, you can create mirrored tasks in SAP Project Management (multi-project management). ● Task Hierarchy - None: You cannot create any subtasks and therefore you cannot set up any task hierarchies. - With Summary Tasks : You can set up task hierarchies but you can carry out certain tasks only for tasks that do not have any subtasks, for example, confirming time,specifying qualifications, and assigning project roles. You can collect this information for the subtasks and display it together for the superior summary task. - Without Summary Tasks : You can set up task hierarchies and you can execute all the activities at each level of the task hierarchy. There are no summary tasks. ● Activate Status Reports - Status Reports: If this checkbox is selected, you can generate status reports. You have your own tab page to do this. The reports are checked in using SAP Project Management.- - Check in Status Reports in SAP DMS: If this checkbox is selected, the status reports are checked in using SAP DMS. ● Resource Management - Resource Search : If this checkbox is selected, the resource search is available in SAP Project Management on the Resources tab page. - Qualifications: If this checkbox is selected, you can define qualifications for tasks and roles in SAP Project Management. ● Evaluations and Dashboard - Check for Threshold Value Violations : If this is selected, you can set the way the threshold values are checked in the system. - Aggregate Severities : If this checkbox is selected, you can control whether severities are aggregated when you are editing the project. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 146
155.
7/26/2020 SAP e-book 1/1 -
Use Dashboard: If this checkbox is selected, the system considers projects with this project type in the evaluations for the dashboard. In the dashboard, the system then displays various data for the project, for example, key performance indicators (KPIs). If this checkbox is not selected, the system does not display any data or it displays the initial value for the project in the dashboard. Figure 78: Configuration of Project Type — Further Settings Additional sections of the project type are as follows: ● Accounting integration The following scenarios are available to connect an accounting system, such as SAP S/ 4HANA Financial Controlling (FI/CO): - No Integration: If you choose this scenario, you cannot specify certain accounting- specific data in the project. - Accounting integration in ERP: If you choose this scenario, the integration occurs using the account assignment manager in controlling. The system provides additional functions in the project to access the data of the account assignment object, and to edit it further in SAP S/4HANA or another external SAP S/4HANA/ ERP system. ● Type of Transfer You can choose from the following transfer settings: - Always Automatic When Saving: Each time you save the data it is transferred to the accounting system, regardless of the status of the project. Lesson: Project Structures © Copyright. All rights reserved. 147
156.
7/26/2020 SAP e-book 1/1 -
Automatic As of “Flagged for Transfer/To Assign” : The first transfer occurs after the user has set the status For Transfer and has saved the project. Then an update is performed when you save the project. - Automatic As of Release of Project : The first transfer occurs after you release the project. Then an update is performed when you save the project. ● Scheduling Scheduling determines how a project is scheduled. You can either choose the Top-Down or Bottom-Up scheduling type. If you use summary tasks for your task hierarchies, you can set only Bottom-Up here. The combination with summary tasks and Top-Down is not possible. The scheduling type can be changed later in the operative project if required. ● Confirmation - Time Recording: This defines the project elements for which times can be entered (tasks or project roles). - Time Recording for Project Definition : If this checkbox is selected, you can enter the time not just for the selected project element but also for the project definition. - Time/Travel Expenses Rec. CATS/SRM/FIN : If this checkbox is selected, time recording is performed using the CATS (Cross Application Timesheet) for example. You can enter travel expenses in SAP Travel Management. If you have selected the checkbox, you cannot enter any more actual times directly in SAP Project Management. ● Digital signature for approvals - Signature of Approval with User Certificate : If this checkbox is selected, user certificates are used for the signature of the individual approvals in SAP Project Management. Otherwise, the signature is created when you enter the user and password. ● Field control This check box defines which field control profile is used for a project type. A standard setting of 0SAP is delivered for the field control. If you do not specify a field control profile for a project type, the default setting 0SAP is used Phase type You can define the phase type on the Basic Data tab page of a phase. The phase type profile in Customizing describes the approval process of a phase and its effects on the other phases. For example, the phase type can determine that an approval process is to be carried out and that the successor phase can only be released after the predecessor phase has been approved. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 148
157.

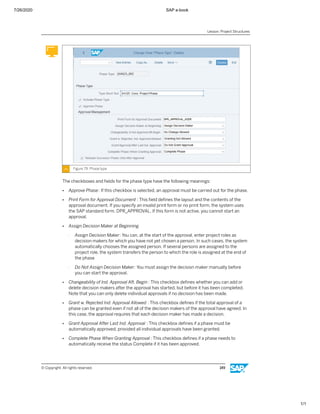

7/26/2020 SAP e-book 1/1 Figure
79: Phase type The checkboxes and fields for the phase type have the following meanings: ● Approve Phase: If this checkbox is selected, an approval must be carried out for the phase. ● Print Form for Approval Document : This field defines the layout and the contents of the approval document. If you specify an invalid print form or no print form, the system uses the SAP standard form, DPR_APPROVAL. If this form is not active, you cannot start an approval. ● Assign Decision Maker at Beginning - Assign Decision Maker: You can, at the start of the approval, enter project roles as decision makers for which you have not yet chosen a person. In such cases, the system automatically chooses the assigned person. If several persons are assigned to the project role, the system transfers the person to which the role is assigned at the end of the phase - Do Not Assign Decision Maker: You must assign the decision maker manually before you can start the approval. ● Changeability of Ind. Approval Aft. Begin : This checkbox defines whether you can add or delete decision makers after the approval has started, but before it has been completed. Note that you can only delete individual approvals if no decision has been made. ● Grant w. Rejected Ind. Approval Allowed : This checkbox defines if the total approval of a phase can be granted even if not all of the decision makers of the approval have agreed. In this case, the approval requires that each decision maker has made a decision. ● Grant Approval After Last Ind. Approval : This checkbox defines if a phase must be automatically approved, provided all individual approvals have been granted. ● Complete Phase When Granting Approval : This checkbox defines if a phase needs to automatically receive the status Complete if it has been approved. Lesson: Project Structures © Copyright. All rights reserved. 149
158.
7/26/2020 SAP e-book 1/1 ●
Release Successor Phase Only After Approval : If this checkbox is selected, you can release a successor phase only if the current phase has the status Approved. If this checkbox is not selected, when a successor phase is released, the system checks only whether the current phase has already been released. You can activate and deactivate individual phase types. Checklist Type and Task Type Figure 80: Checklist Type and Task Type The checklist type describes the type of the checklist in a short text. The checklist type is used to group checklists of the same type. The checklist contains the Issue List checkbox. If this checkbox is selected, the checklist is interpreted as an issue list. Issue lists describe items that are unplanned, however, but that are important for the project. Issue lists are also used as lists of items that are still open. Issue lists involve the whole project, and therefore are often assigned in the project definition. You can activate and deactivate individual checklist types. The task type describes the type of the task in a short text. It groups tasks of the same type. You can assign cost and revenue rates to a task type. This assignment is necessary due to different costing scenarios. For example, costings can be related to the project role or to the structure element. You can activate and deactivate individual task types. Managing Documents Business Example As a project manager, you need to access the data related to your project, such as descriptions, procedures, and so on. This data is distributed over different PCs and cannot be accessed centrally. For this reason, you require the following knowledge: ● An understanding of how to manage documents directly in SAP Project Management Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 150
159.

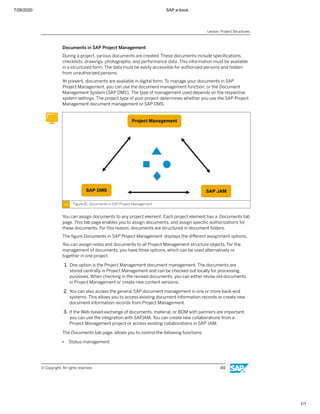

7/26/2020 SAP e-book 1/1 Documents
in SAP Project Management During a project, various documents are created. These documents include specifications, checklists, drawings, photographs, and performance data. This information must be available in a structured form. The data must be easily accessible for authorized persons and hidden from unauthorized persons. At present, documents are available in digital form. To manage your documents in SAP Project Management, you can use the document management function, or the Document Management System (SAP DMS). The type of management used depends on the respective system settings. The project type of your project determines whether you use the SAP Project Management document management or SAP DMS. Figure 81: Documents in SAP Project Management You can assign documents to any project element. Each project element has a Documents tab page. This tab page enables you to assign documents, and assign specific authorizations for these documents. For this reason, documents are structured in document folders. The figure Documents in SAP Project Management displays the different assignment options. You can assign notes and documents to all Project Management structure objects. For the management of documents, you have three options, which can be used alternatively or together in one project. 1. One option is the Project Management document management. The documents are stored centrally in Project Management and can be checked out locally for processing purposes. When checking in the revised documents, you can either revise old documents in Project Management or create new content versions. 2. You can also access the general SAP document management in one or more back-end systems. This allows you to access existing document information records or create new document information records from Project Management. 3. If the Web-based exchange of documents, material, or BOM with partners are important, you can use the integration with SAPJAM. You can create new collaborations from a Project Management project or access existing collaborations in SAP JAM. The Documents tab page, allows you to control the following functions: ● Status management Lesson: Project Structures © Copyright. All rights reserved. 151
160.
7/26/2020 SAP e-book 1/1 ●

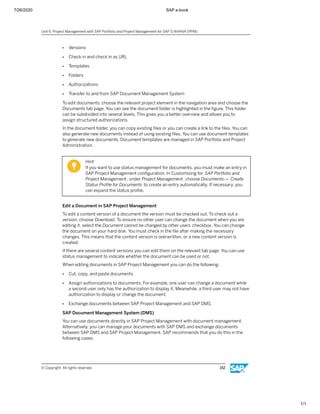

Versions ● Check in and check in as URL ● Templates ● Folders ● Authorizations ● Transfer to and from SAP Document Management System To edit documents, choose the relevant project element in the navigation area and choose the Documents tab page. You can see the document folder is highlighted in the figure. This folder can be subdivided into several levels. This gives you a better overview and allows you to assign structured authorizations. In the document folder, you can copy existing files or you can create a link to the files. You can also generate new documents instead of using existing files. You can use document templates to generate new documents. Document templates are managed in SAP Portfolio and Project Administration. Hint: If you want to use status management for documents, you must make an entry in SAP Project Management configuration. In Customizing for SAP Portfolio and Project Management, under Project Management, choose Documents→ Create Status Profile for Documents to create an entry automatically. If necessary, you can expand the status profile. Edit a Document in SAP Project Management To edit a content version of a document the version must be checked out. To check out a version, choose Download. To ensure no other user can change the document when you are editing it, select the Document cannot be changed by other users checkbox. You can change the document on your hard disk. You must check in the file after making the necessary changes. This means that the content version is overwritten, or a new content version is created. If there are several content versions you can edit them on the relevant tab page. You can use status management to indicate whether the document can be used or not. When editing documents in SAP Project Management you can do the following: ● Cut, copy, and paste documents. ● Assign authorizations to documents. For example, one user can change a document while a second user only has the authorization to display it. Meanwhile, a third user may not have authorization to display or change the document. ● Exchange documents between SAP Project Management and SAP DMS. SAP Document Management System (DMS) You can use documents directly in SAP Project Management with document management. Alternatively, you can manage your documents with SAP DMS and exchange documents between SAP DMS and SAP Project Management. SAP recommends that you do this in the following cases: Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 152
161.
7/26/2020 SAP e-book 1/1 ●
You already use SAP DMS and you want access to the existing SAP DMS documents. ● You want to exchange your documents between the SAP system and SAP Project Management. ● You want to classify your documents. ● You want to map your project structure using SAP DMS document structure. Figure 82: DMS documents in SAP Project Management Reasons for using the integration between SAP Project Management and SAP DMS are as follows: ● You can create links to existing document information records in SAP DMS or you can create new document information records. ● You can create new information records with or without reference to templates. The top section of the figure, DMS Documents in SAP Project Management, shows you how a project element is linked to a document information record. As soon as there is a link to document information records, you can display the assigned original files. If necessary, you can transfer these original files to SAP Project Management or to the project status reports. You can also transfer them in the opposite direction: you can copy status reports, their documents, or documents from SAP Project Management to SAP DMS in information records. Hint: SAP Project Management uses document information records that are assigned to document structures — document bill of materials (BOM). The document information records defined in these structures contain the original files. The lower section of the figure DMS documents in SAP Project Management shows you the document structure assigned to an information record. You can use Open Application to access a number of editing functions for the document information record. As for the object links, in addition to the predefined editing transactions, you can also include your own editing transactions. If documents are assigned to several project elements, for example, the project definition and some phases, these can be grouped together to form a whole document structure. The system transfers the document information records of a subordinate project element to the document structure of a superior project element. Lesson: Project Structures © Copyright. All rights reserved. 153
162.
7/26/2020 SAP e-book 1/1 Configuration
of SAP Project Management and SAP DMS Integration You configure the integration of SAP Project Management and SAP DMS in at least two places. In SAP Project Management, you configure settings for the object link. That is, you determine remote function call (RFC) destinations, web servers, and you assign editing transactions for documents to them. The settings are the same as those for the general object link. If you want to use integration with several DMS systems you must create further object types, for example, as copies of the existing object types. To configure integration in Customizing for SAP Portfolio and Project Management, under Project Management, choose Documents→ Define Object Links for Documents in DMS. In addition, you must configure settings in the SAP DMS system. This setting determines which document types of the SAP DMS are to be used as soon as new document information records are created from SAP Project Management. In SAP DMS configuration, you must determine the document types that permit an integration with SAP Project Management. You can find detailed information about this in the SAP Project Management configuration guide. To configure integration in SAP DMS in Customizing, under Integration with Other SAP Components for SAP Portfolio and Project Management , choose Project Management → SAP DMS Integration → Specify Default Document Types per Project Management System . Use of SAP Jam as a Collaboration Platform SAP Jam is a social collaboration and decision-making solution that brings people, processes, information, and applications together to enable better problem-solving and decision-making. SAP Jam allows enterprises to use social networking to allow their employees and partners to collaborate on projects, learn, and innovate together. SAP Jam is designed to drive results by structuring conversations and enabling people to make informed decisions and solve business-critical problems. SAP Jam provides features such as polls, activity feeds, blogs, video and document sharing, versioning, wikis, public groups, and private groups to help employees quickly connect with one another, and create and share critical information. SAP Jam may be used as an online collaboration platform to share your project documents, proposals, and ideas outside of the project document management or SAP DMS. SAP Fiori applications available for SAP Portfolio and Project Management (PPM) support direct sharing of your data on SAP Jam. Authorizations in SAP Project Management Business Scenario As a project manager you want to control the users that have access to certain aspects of the projects. Some users only have permission to view documents, others have permission to edit documents, and in some cases some users are not authorized to access the documents at all. You can use SAP Project Management to control general authorizations and project-specific authorizations. Authorizations Authorizations ensure that only authorized persons can view or edit a project or part of a project. The project manager handles the authorizations for the project. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 154
163.
7/26/2020 SAP e-book 1/1 Figure

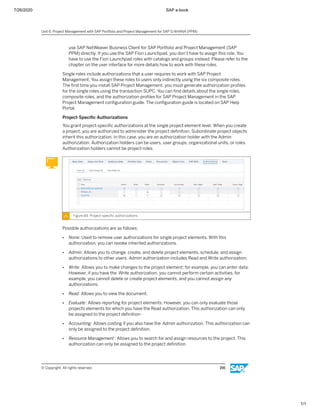

83: Authorizations in SAP Project Management General Authorizations The assignment of single and composite roles in the user master record helps in maintaining general authorizations. The composite roles in the standard system are as follows: ● SAP_CPR_DECISION_MAKER (SAP Project Management decision maker) ● SAP_CPR_INTERESTED (SAP Project Management interested party) ● SAP_CPR_MEMBER (SAP Project Management team member) ● SAP_CPR_PROJECT_LEAD (SAP Project Management project manager) ● SAP_CPR_RESOURCE_MANAGER (SAP Project Management resource manager) ● SAP_CPR_TEMPLATE_RESPONSIBLE (SAP Project Management template responsible) ● SAP_CPR_BCV_USER_COMP (SAP Project Management composite role) Composite roles are made up of the following single roles: ● SAP_CPR_PROJECT_ADMINISTRATOR: This role allows you to create projects ● SAP_CPR_TEMPLATE_ADMINISTRATOR: This role allows you to edit project templates, checklist templates, and control plan templates. ● SAP_CPR_USER: This role controls general authorizations to work with SAP Project Management. It also controls cross-application settings, for example, editing business partners. ● SAP_CPR_BCV_USER: This role is necessary to activate the Business Context Viewer (BCV) for resource management in SAP Project Management. ● SAP_BPR_PPM: This role provides the standard navigation menu definition for SAP NetWeaver Business Client, therefore, this role must be assigned to each user when you Lesson: Project Structures © Copyright. All rights reserved. 155
164.
7/26/2020 SAP e-book 1/1 use
SAP NetWeaver Business Client for SAP Portfolio and Project Management (SAP PPM) directly. If you use the SAP FIori Launchpad, you don’t have to assign this role. You have to use the Fiori Launchpad roles with catalogs and groups instead. Please refer to the chapter on the user interface for more details how to work with these roles. Single roles include authorizations that a user requires to work with SAP Project Management. You assign these roles to users only indirectly using the six composite roles. The first time you install SAP Project Management, you must generate authorization profiles for the single roles using the transaction SUPC. You can find details about the single roles, composite roles, and the authorization profiles for SAP Project Management in the SAP Project Management configuration guide. The configuration guide is located on SAP Help Portal. Project-Specific Authorizations You grant project-specific authorizations at the single project element level. When you create a project, you are authorized to administer the project definition. Subordinate project objects inherit this authorization. In this case, you are an authorization holder with the Admin authorization. Authorization holders can be users, user groups, organizational units, or roles. Authorization holders cannot be project roles. Figure 84: Project-specific authorizations Possible authorizations are as follows: ● None: Used to remove user authorizations for single project elements. With this authorization, you can revoke inherited authorizations. ● Admin: Allows you to change, create, and delete project elements, schedule, and assign authorizations to other users. Admin authorization includes Read and Write authorization. ● Write: Allows you to make changes to the project element; for example, you can enter data. However, if you have the Write authorization, you cannot perform certain activities, for example, you cannot delete or create project elements, and you cannot assign any authorizations. ● Read: Allows you to view the document. ● Evaluate: Allows reporting for project elements. However, you can only evaluate those projects elements for which you have the Read authorization. This authorization can only be assigned to the project definition- ● Accounting: Allows costing if you also have the Admin authorization. This authorization can only be assigned to the project definition. ● Resource Management : Allows you to search for and assign resources to the project. This authorization can only be assigned to the project definition. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 156
165.
7/26/2020 SAP e-book 1/1 ●
Staffing Manager: Helps the system display all project roles with the Resource Manager via Authorization staffing type, in the worklist of external resource management applications. This authorization can only be assigned to the project definition. ● Candidate Manager: Helps the system display all project roles with the Resource Manager via Authorization staffing type in the worklist of external resource management applications. This authorization can only be assigned to the project definition. The above descriptions do not cover all the allowed or barred activities for the single authorizations. There are various exceptions and special cases. Refer to the online help of the SAP system for more details. The figure Project-specific authorizationsshows a screenshot of the authorization maintenance screen for a task. On this screen, you can manually change authorizations or add further authorization holders. Alternatively, project team members receive authorizations for a project when you assign them to the project as a resource (business partner) in resource planning. You can do this by staffing project roles. You create project roles regarding previously specified project role types. These project role types determine the default authorizations for these business partners. A user can receive conflicting authorizations for editing an individual project element. For example, users may receive Write authorization, and because they are assigned to a user group, they may be assigned Read authorization. In this case, the authorization is prioritized according to the authorization holder. Authorizations have the following priority levels: ● User-related authorizations have priority over user group authorizations. ● User group authorizations have priority over organizational unit authorizations. ● Organizational unit authorizations have priority over role assignment authorizations. Hint: Users can receive authorizations automatically during the staffing of project roles. If the staffing is deleted, these authorizations are not automatically removed. You must remove the authorizations manually. Users can also receive authorizations via authorization from SAP Portfolio Management using DFM (Decision Flow Management). The transfer works both ways. Super user concept LESSON SUMMARY You should now be able to: ● Configuration of project structures ● Document Management ● Authorizations in SAP S/4HANA Project Management Lesson: Project Structures © Copyright. All rights reserved. 157
166.
7/26/2020 SAP e-book 1/1 Unit

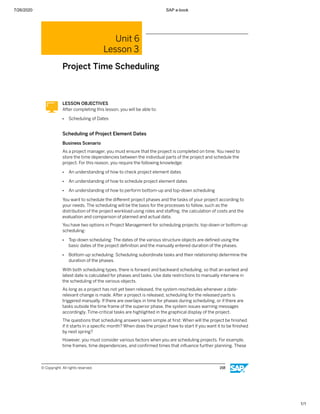

6 Lesson 3 Project Time Scheduling LESSON OBJECTIVES After completing this lesson, you will be able to: ● Scheduling of Dates Scheduling of Project Element Dates Business Scenario As a project manager, you must ensure that the project is completed on time. You need to store the time dependencies between the individual parts of the project and schedule the project. For this reason, you require the following knowledge: ● An understanding of how to check project element dates ● An understanding of how to schedule project element dates ● An understanding of how to perform bottom-up and top-down scheduling You want to schedule the different project phases and the tasks of your project according to your needs. The scheduling will be the basis for the processes to follow, such as the distribution of the project workload using roles and staffing, the calculation of costs and the evaluation and comparison of planned and actual data. You have two options in Project Management for scheduling projects: top-down or bottom-up scheduling: ● Top-down scheduling: The dates of the various structure objects are defined using the basic dates of the project definition and the manually entered duration of the phases. ● Bottom-up scheduling: Scheduling subordinate tasks and their relationship determine the duration of the phases. With both scheduling types, there is forward and backward scheduling, so that an earliest and latest date is calculated for phases and tasks. Use date restrictions to manually intervene in the scheduling of the various objects. As long as a project has not yet been released, the system reschedules whenever a date- relevant change is made. After a project is released, scheduling for the released parts is triggered manually. If there are overlaps in time for phases during scheduling, or if there are tasks outside the time frame of the superior phase, the system issues warning messages accordingly. Time-critical tasks are highlighted in the graphical display of the project. The questions that scheduling answers seem simple at first: When will the project be finished if it starts in a specific month? When does the project have to start if you want it to be finished by next spring? However, you must consider various factors when you are scheduling projects. For example, time frames, time dependencies, and confirmed times that influence further planning. These © Copyright. All rights reserved. 158
167.
7/26/2020 SAP e-book 1/1 factors
make scheduling complex. When will the project be finished if the third phase cannot begin before the fourth quarter, and the first phase is three weeks behind schedule? To meet scheduling requirements, SAP Project Management provides automatic and manual scheduling. Figure 85: Project Element Dates The figure, Project Element Dates, shows project elements and the date types that you can maintain for each element. Not every date type is available for each project element type, for example, you can only enter actual dates for tasks and checklist items. For scheduling, calendars can be assigned to each project element separately. You can define various calendars in Customizing for the SAP system in which SAP Project Management is set up. Figure 86: Graphical Display of Dates The figure, Graphical Display of Dates, provides you with an overview of the time frame for individual project elements. Critical dates are displayed as red bars in the graphical overview. Constraints are represented by yellow bars. You can show additional information on tasks and phases tasks in the GANTT chart. Collective tasks can be shown in a different colors. In the graphical display of dates, you can perform the following functions ● Zoom in and out ● Adjust dates and duration of phases and tasks Lesson: Project Time Scheduling © Copyright. All rights reserved. 159
168.
7/26/2020 SAP e-book 1/1 ●
Print a Gantt Chart ● Filter certain objects or statuses ● Copy calculated dates to forecasted dates ● eCompare dates, such as calculated dates and forecasted dates ● Create and maintain relationships ● Open a detail screen, for example, for tasks Project Scheduling The system performs scheduling automatically in the Created status. Date-relevant changes trigger a rescheduling in the background. The system displays information about rescheduling in the message log. When a part of the project is released, it is not scheduled automatically; you must do this manually. You can carry out scheduling from any project element. SAP Project Management uses either top-down or bottom-up scheduling. The Project Type checkbox controls the type of scheduling. The system calculates the dates forward and backward and determines the earliest and latest dates. You can use the float times for the individual project elements to compare the earliest and latest dates. The float time of a task defines whether the task is critical (that is, the float time is less than or equal to zero days) and therefore has a red bar. Checkboxes for the user-specific settings control the graphical display. You can choose between the earliest and latest dates for structure elements of SAP Project Management. For object links (for example, with work breakdown structure elements) you can define a date type (for example, a basic date). This date type is then displayed in the graphical display. . You can deactivate automatic scheduling for specific users. In this case, the affected users can only schedule manually. The figure, User-Specific Scheduling Settings, shows a screenshot of the user-specific setting in question. Features and Functions of the GANTT Chart Additional information, such as snapshots and simulations, are now shown in a single-project GANTT chart for the project definition and checklist items. The display is controlled by existing user settings for Graphic. The Graphic settings are maintained in SAP Project Management. You can decide which information for project elements is displayed in the single-project GANTT chart and the multi-project monitor. In global customizing, maintain the master switch for User Interface Settings (Area 0006) and activate Display Additional Information on the multi-project monitor (0026 default inactive). The global switch is the pre- requisite for additional information in the multi-project monitor. The default view for the GANTT chart can now by defined in the user settings. The following are possible settings: ● Fit ● Overview ● Year ● Quarter ● Month Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 160
169.
7/26/2020 SAP e-book 1/1 ●
Week The activated user setting prevents the GANTT chart from scrolling automatically to the task start when a task is marked in the tree area. For multiple users, the user setting can be set by report DPR_CHANGE_USER_SETTINGS. The system does not automatically scroll if the dates of the visible project elements are within the left and right data currently displayed in the GANTT chart. Nevertheless, the user can manually trigger scrolling to the marked task start date; use the context menu with Scroll to Start in the tree area. This can also be used in the graphic area of the chart. Scrolling does not place the GANTT one day prior to the start date of the selected project element. The system considers the earliest or latest date according to the general user setting Earl./Lst Dates. The described behavior does apply to the single- project GANTT chart and to the multi-project monitor. Top-Down Scheduling In top-down scheduling, the planned dates of phases depend on the project definition dates and the sequence of the phases. Each phase has a duration that is considered in time scheduling. Phases occur in sequence. In top-down scheduling, the dates of the phases are independent of the dates of the subordinate tasks, checklists, and checklist items. Top-down scheduling is carried out as follows: 1. The system uses the dates of the superior hierarchy to calculate the dates of the subordinate hierarchy. 2. A fixed start date is specified at project definition level. If it is not specified, Project Management sets it to the current date. 3. The system uses this date to calculate forward and determine the earliest date of the project. 4. The system uses the forward calculation to determine the calculated finish date for the project definition. If no fixed finish date is specified, the system calculates backward from the earliest finish of the last phase. The result of backward calculation determines the calculated start date for the project definition. Note: Phases may overlap because of manually entered constraints. However, this leads to warning messages. In general, constraints have a higher priority in scheduling than the calculated dates. The dates of tasks depend on whether the tasks are assigned to a phase, a checklist item, another task, or the project definition. The dates of the tasks of a phase are calculated on the basis of the dates of a phase. The calculation takes into account the relationships of the tasks, the duration, the fixed dates and, if necessary, the actual date. The dates of a task of a checklist item are calculated on the basis of the dates of the phase to which the checklist item belongs. The dates of subordinate tasks are calculated on the basis of the dates of the superordinate tasks. Dates of tasks also depend on the duration of the respective task and its relationship to other tasks. In this case, constraints have a higher priority than the calculated dates. Checklist items do not have a time frame, duration, or start date. Checklist items only have finish dates. The finish dates of the checklist items are determined from the latest finish date of the assigned tasks or, if no tasks have been assigned, from the finish date of the phase. Constraints can be removed completely by choosing Check Conflicts. Lesson: Project Time Scheduling © Copyright. All rights reserved. 161
170.
7/26/2020 SAP e-book 1/1 Bottom-Up
Scheduling The system determines the dates of a project element from the dates of the subordinate project element, taking into account the sequence, the duration, the fixed dates, and the actual dates. The system first performs the forward scheduling and then the backward scheduling. Forward scheduling in bottom-up scheduling is carried out as follows: 1. The scheduling of the first task begins based on the start date of the project definition. 2. The dates of the subsequent tasks of the same phase are calculated. If the dates of all tasks in a phase are known, the dates are added up and the duration of the phase is calculated. 3. As soon as the tasks of the first phase are scheduled, the system schedules the tasks of the second phase. In this case, the system takes into account the earliest finish date of the last task of the previous phase, and relationships. In this way, the dates of all tasks and all phases are determined After forward scheduling, the system performs backward scheduling. The starting point is the manually entered or calculated end of the project definition. Scheduling first determines the dates of the last task of the last phase. Then, the system calculates the next-to-last task, and so on. Note: The project type determines the type of scheduling. In the project type, there is also a checkbox defined for the task hierarchies. If the With Summary Tasks checkbox is selected, you must carry out bottom-up scheduling Relationships Figure 87: Relationships of Tasks Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 162
171.

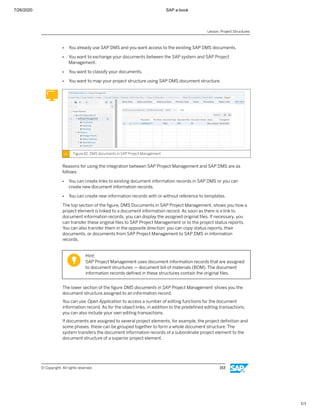

7/26/2020 SAP e-book 1/1 Note: Relationships

link tasks in a project. If there are date relationships between projects, you can set this up in SAP Project Management using Multi-Project Management. In a simple case, you can copy the dates from one task to a second project. To do so, you use a mirrored task, which can affect the scheduling of the dependent project in the same way as a regular task. LESSON SUMMARY You should now be able to: ● Scheduling of Dates Lesson: Project Time Scheduling © Copyright. All rights reserved. 163
172.

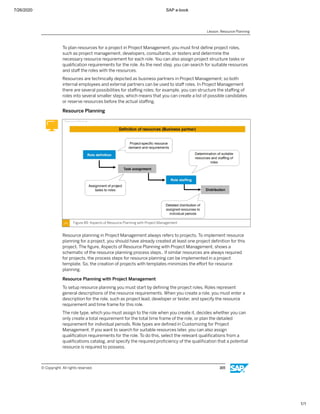

7/26/2020 SAP e-book 1/1 Unit

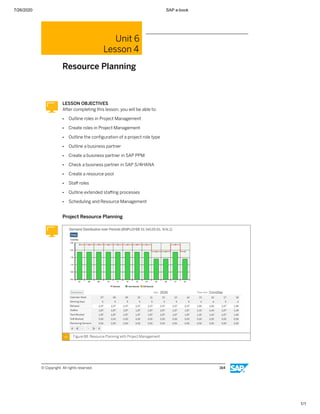

6 Lesson 4 Resource Planning LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline roles in Project Management ● Create roles in Project Management ● Outline the configuration of a project role type ● Outline a business partner ● Create a business partner in SAP PPM ● Check a business partner in SAP S/4HANA ● Create a resource pool ● Staff roles ● Outline extended staffing processes ● Scheduling and Resource Management Project Resource Planning Figure 88: Resource Planning with Project Management © Copyright. All rights reserved. 164
173.
7/26/2020 SAP e-book 1/1 To
plan resources for a project in Project Management, you must first define project roles, such as project management, developers, consultants, or testers and determine the necessary resource requirement for each role. You can also assign project structure tasks or qualification requirements for the role. As the next step, you can search for suitable resources and staff the roles with the resources. Resources are technically depicted as business partners in Project Management; so both internal employees and external partners can be used to staff roles. In Project Management there are several possibilities for staffing roles; for example, you can structure the staffing of roles into several smaller steps, which means that you can create a list of possible candidates or reserve resources before the actual staffing. Resource Planning Figure 89: Aspects of Resource Planning with Project Management Resource planning in Project Management always refers to projects. To implement resource planning for a project, you should have already created at least one project definition for this project. The figure, Aspects of Resource Planning with Project Management, shows a schematic of the resource planning process steps.. If similar resources are always required for projects, the process steps for resource planning can be implemented in a project template. So, the creation of projects with templates minimizes the effort for resource planning. Resource Planning with Project Management To setup resource planning you must start by defining the project roles. Roles represent general descriptions of the resource requirements. When you create a role, you must enter a description for the role, such as project lead, developer or tester, and specify the resource requirement and time frame for this role. The role type, which you must assign to the role when you create it, decides whether you can only create a total requirement for the total time frame of the role, or plan the detailed requirement for individual periods. Role types are defined in Customizing for Project Management. If you want to search for suitable resources later, you can also assign qualification requirements for the role. To do this, select the relevant qualifications from a qualifications catalog, and specify the required proficiency of the qualification that a potential resource is required to possess. Lesson: Resource Planning © Copyright. All rights reserved. 165
174.
7/26/2020 SAP e-book 1/1 You
can also assign tasks to a role. By assigning tasks to a role, you can also incorporate the qualification requirements of the tasks that need suitable resources later. If you use the CATS time sheet for confirming tasks in project management, the assignment of tasks is also useful for filling the CATS worklist. After defining a role and assigning tasks, you can staff the role with resources, and distribute the role requirement to the individual resources. The project type and the role type decide how the suitable resources are to be determined, and how and by whom the roles are staffed with resources. You can use both internal and external resources to staff a role, because the resources are technically represented as business partners in Project Management. You can create business partners manually in SAP Portfolio and Project Management, or you can use Human Capital Management integration to derive them from HR master data from SAP Human Capital Management. If you have staffed a role with one or more resources and the role type provides a distribution, you can distribute the planned requirement of the role to the assigned resources specific to the period (day, week, or month). These resources can be distributed within project processing, centrally and across all projects, using the SAP Portfolio and Project Management fast entry screens. Hint: The definition and staffing of roles is relevant not only for resource planning in Project Management. In Project Management, you can assign a responsible role to every structure element. This assignment makes it easier for the responsible users to access the processing of objects. This assignment is also useful in alert management for determining recipients of notifications for threshold value violations or date shifts of linked projects. To determine unique responsible users in structure elements, you must first have defined roles in the project and staffed the roles with resources. Hint: In SAP Portfolio and Project Management, roles are also used in connection with initiatives. However, this does not map resource planning but depicts persons involved in the initiative. For initiatives, you can define Stakeholders. You can then assign these Stakeholders as persons responsible for the initiative. The corresponding roles are staffed with business partners. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 166
175.
7/26/2020 SAP e-book 1/1 Example
of the Definition and Staffing of Roles Figure 90: Example of the Definition and Staffing of Roles The figure, Example of the Definition and Staffing of Roles, shows the basic resource planning in Project Management. The figure does not show a distribution of role requirements and resource staffing. The assignment of a role function to a role as displayed in the figure serves to integrate the resource planning data of a project with the capacity planning of an assigned portfolio item in SAP Portfolio and Project Management. Scenarios From Staffing Status The staffing status of a role indicates the following scenarios: ● If a project role is not yet staffed, the system displays a red traffic light. ● If a project role is already staffed but the role requirement is not yet fully distributed to the assigned resource or resources, the system displays a yellow triangle as a staffing status. ● If a project role is staffed, and the role requirement is fully assigned to the resources as required capacity, this is documented by a green icon. ● If a project role is overstaffed, that is, if you have distributed more required capacity to the assigned resource or resources than is planned for the role, the system displays a green traffic light with a yellow circle. Roles in Project Management Roles are created specifically for the project with reference to the definition of a project. When you create a role, you specify a name for the role and a more detailed description. To specify a role in more detail, you can define a location for the role, define notes, or link documents with the role. When you create a role, you must select a role type that controls the basic properties for the definition of the role requirements and the later staffing of the role. Role types are defined and assigned to a project type in Customizing for Project Management. When you create roles for a project, you can only access the role types that are assigned to the project type. Lesson: Resource Planning © Copyright. All rights reserved. 167
176.
7/26/2020 SAP e-book 1/1 When
you enter a role function in the definition of a role, the system allows you to integrate the role requirements and the required capacities distributed to assigned resources in SAP Portfolio and Project Management capacity planning. You can also use the role function to evaluate resource data of similar roles in BI reporting across all projects. This means that you can define a role function, such as project management, and assign it to the corresponding roles in your projects. In reporting, you can evaluate all requirements for this role function in an aggregated form, regardless of what the individual roles in the projects are called. Configuration of a Role in Project Management To define the resource requirement, you can first determine the possible timeframe containing the resource requirements for this role. If you do not enter a timeframe, the system uses the basic dates of the project definition as a validity period for the role. The definition of the planned required capacity for the role depends on the role type. If the role type does not allow the distribution of required capacities, just enter a total required capacity for the complete validity period when you define a role. If you have assigned project structure tasks to the role, you can also transfer the planned work of the tasks as the total required capacity. If you want to use the SAP Portfolio and Project Management fast entry screens for a cross- project resource overview, you must configure the roles so that a distribution of required capacities is allowed. In this case, do not enter a total required capacity in the definition of the role, but distribute required capacities to individual periods. The time unit for the distribution (for example, hours, days, or user-defined time units, such as consultant day) is defined in the project definition, along with the period type that is to be used for the distribution. Possible period types are weeks, months, or a generic interval. If you select a generic interval as the period type, you can plan the periods as you choose. However, there must be no gaps between the periods and they must not overlap. A check function helps you to define intervals without any errors. If you use fast entry screens, you must select weeks or months as the period type. When distributing required capacities, you can either manually assign the required capacities to the individual periods or you can use a distribution function to set the required capacities for several periods simultaneously. You can even increase or decrease the required capacities by certain amounts. If you have assigned tasks to the role, you can also transfer the planned work of the tasks that you assigned to the role as distributed required capacity. When you distribute required capacities to periods, the system displays the number of working days of the individual periods. It also displays for each period how much required capacity was already distributed to assigned resources and how much is still to be distributed. If you specify a location for a role, the system derives the number of working days per period from the factory calendar of the location; otherwise it uses the general settings for distribution in Customizing for Project Management to determine the working days. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 168
177.

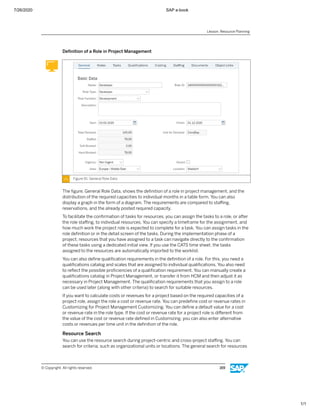

7/26/2020 SAP e-book 1/1 Definition
of a Role in Project Management Figure 91: General Role Data The figure, General Role Data, shows the definition of a role in project management, and the distribution of the required capacities to individual months in a table form. You can also display a graph in the form of a diagram. The requirements are compared to staffing, reservations, and the already posted required capacity. To facilitate the confirmation of tasks for resources, you can assign the tasks to a role, or after the role staffing, to individual resources. You can specify a timeframe for the assignment, and how much work the project role is expected to complete for a task. You can assign tasks in the role definition or in the detail screen of the tasks. During the implementation phase of a project, resources that you have assigned to a task can navigate directly to the confirmation of these tasks using a dedicated initial view. If you use the CATS time sheet, the tasks assigned to the resources are automatically imported to the worklist. You can also define qualification requirements in the definition of a role. For this, you need a qualifications catalog and scales that are assigned to individual qualifications. You also need to reflect the possible proficiencies of a qualification requirement. You can manually create a qualifications catalog in Project Management, or transfer it from HCM and then adjust it as necessary in Project Management. The qualification requirements that you assign to a role can be used later (along with other criteria) to search for suitable resources. If you want to calculate costs or revenues for a project based on the required capacities of a project role, assign the role a cost or revenue rate. You can predefine cost or revenue rates in Customizing for Project Management Customizing. You can define a default value for a cost or revenue rate in the role type. If the cost or revenue rate for a project role is different from the value of the cost or revenue rate defined in Customizing, you can also enter alternative costs or revenues per time unit in the definition of the role. Resource Search You can use the resource search during project-centric and cross-project staffing. You can search for criteria, such as organizational units or locations. The general search for resources Lesson: Resource Planning © Copyright. All rights reserved. 169
178.
7/26/2020 SAP e-book 1/1 also
allows you to search for business partners who had a certain project role in the past, or who have already been responsible for a particular customer. The result of the resource search is a list of suitable business partners. You can use this list to assign business partners directly to the project role or enter them as candidates in a candidate list. Project Role Type Configuration Figure 92: Project Role Type To create roles in a Project Management project, you must first define suitable project role types in Customizing for Project Management, and assign them to the project type. The figure, Project Role Type, shows the definition of a project role type. The staffed by field in the project role type controls who is allowed to staff roles with resources in this role type in the following scenarios: ● Project Lead The project role is staffed by the project lead or a resource manager within the project. For this, the Administration and Resource Management authorizations are required in the Project Management project. ● Resource Manager through Authorization In SAP Portfolio and Project Management, users with the Staffing Manager or Candidate Manager authorizations can view the corresponding roles in a fast entry screen. The users can then use the fast entry screen to navigate to the staffing of the roles, or to the creation of a candidate list for the relevant roles. ● Resource Manager through Responsible Organization Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 170
179.
7/26/2020 SAP e-book 1/1 The
roles are staffed using the extended staffing process. In SAP Portfolio and Project Management, the staffing or selection of suitable candidates can be performed using a fast entry screen. If you want to distribute role requirements to individual periods, that is, if you want to use the fast entry screens in SAP Portfolio and Project Management, select the Distribution checkbox in the role type. If you want to staff a role with more than one resource at one time, select the Edit in Parallel checkbox in the corresponding role type. In the definition of role types and in the definition of project types, you must assign a role type to project types in Customizing for Project Management. When you create a role type, you can also assign default authorizations to the role type. If a role for this role type is staffed with resources in Project Management, the resources automatically receive these default authorizations in the corresponding project at the project definition level. If you want to integrate resource planning data from Project Management with SAP Portfolio and Project Management capacity planning, you must assign role functions to roles. You define role functions in Customizing for Project Management. To define a role function, you only specify an identification and a name, such as Project Management, Quality Management, or Development. Business Partners Figure 93: Business Partners The resources that you can use for the staffing of roles in Project Management projects and, therefore, for resource planning are depicted technically as business partners in SAP Portfolio and Project Management. Resources Represented by Business Partner A business partner can represent either of the following resources: ● An external resource For example, an external consultant or developer who supports in the execution of IT projects Lesson: Resource Planning © Copyright. All rights reserved. 171
180.
7/26/2020 SAP e-book 1/1 ●
An internal resource For example, employees of your own company A business partner can include general information, such as the name or address data, as well as information about the availability, location, or qualifications of the resource. Business Partner in SAP PPM Figure 94: Creating Business Partners as SAP Portfolio and Project Management Administrator There are several options for creating business partners. One method is to generate business partners using HCM integration with the existing HR data of employees and update them later, if necessary. When maintaining personnel numbers in HCM, the system automatically creates a business partner with the corresponding role in background and assigns personnel number and user ID to this business partner. Manual Business Partner Creation To create business partners manually, that is, without the HCM integration, use one of the following methods: ● Use transaction BP in the SAP Portfolio and Project Management core system. ● Create the business partners directly in SAP Portfolio and Project Management. Hint: When you create a business partner directly in SAP Portfolio and Project Management, you cannot enter all business partner data. Add data, such as qualifications, in the core system later, if required. If you want to use personnel- number related applications such as CATS (Cross Application Time Sheet) you have to maintain the personnel number first. The Resources view allows an SAP Portfolio and Project Management administrator to analyze, create, and change business partners. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 172
181.
7/26/2020 SAP e-book 1/1 Additional
Business Partner Details The administrator can add the following additional details for a business partner: ● Availability during certain periods ● Location assignment during certain periods ● Specification about the periods in which the business partner is active or inactive Business Partners in SAP S/4HANA To create or change business partners in the core system, you can use transaction BP, Maintain Business Partner. When creating business partners in the transaction BP, use the business partner role Employee with the technical identification BUP003. If you also want to assign a cost or revenue rate for costing in Project Management, define the business partner role Resource with the technical identification WFM001. Business Partner Qualifications To assign qualifications manually to a business partner, in the core system, you can use transaction PPPM, Change Qualifications Profile. Using transaction OOQA, Change Qualification Catalog, you can manually create qualifications catalogs in the core system, or add any additional qualifications to catalogs that you transferred from an HCM system. If you do not want to transfer the definition from an HCM system, you can manually define scales for possible qualification proficiencies in Customizing. You can also use transaction RPM_EMPDATA, Employee Overview, to analyze and edit business partners. This transaction is useful to check the completeness of data for resources. Lesson: Resource Planning © Copyright. All rights reserved. 173
182.
7/26/2020 SAP e-book 1/1 Resource
Pool Figure 95: Definition of a Resource Pool You can combine several business partners in a resource pool in SAP PPM. You can then assign one or more resource managers to a resource pool, so they can analyze the capacity utilization of resources of the pool and their assignment to project roles on the Resources fast entry screen, and, if necessary, change the temporal distribution of the resources to project roles. Role Staffing After you have defined project roles in a Project Management project, the roles can be staffed with resources. Role staffing means that you assign business partners to the project roles as resources. You also specify the validity period of this assignment and the work effort that is expected of the resource in this role. Depending on the setting of the role type, the work effort can be assigned in the form of a total required capacity, or distributed to individual periods. To be able to use fast entry screens in SAP Portfolio and Project Management, the role type must provide a distribution of required capacities. If the project type of a Project Management project allows, you can use a resource search to determine suitable resources. The search function transfers all data necessary for the search from the project role definition as search criteria; the search criteria include the validity period and the location, the qualification requirements, or the role requirement. The search criteria can be changed in the search function without changing the attributes of the project role. In this way, you can specify additional qualification requirements for the search. You can also enter additional search criteria. For example, you can restrict the search to resources that have already worked for certain customers or ordering parties, or to resources of certain organizational units. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 174
183.
7/26/2020 SAP e-book 1/1 After
you have determined the search criteria and started a search, you receive a list of the resources that were determined as suitable candidates according to your search criteria. The list of search results provides information and functions that can help you as you continue processing. You have the option of navigating to the detailed data of a resource or view a list of existing assignments to project roles of other projects. The system also displays the manager of each resource in the search result list. When you have decided on a particular resource from the list, you can e-mail the relevant manager of the resource to notify them of the project. You can store resources as candidates or firmly assign them to a project, straight from the list. Resource Preference Candidates are resources that you want to designate for a particular project role. They may include your personal preferences, a customer’s preferences, or resources that the resource search found suitable but you do not yet want to firmly book the resource. You can enter a note for each of your candidates that have relevant information, such as any agreements reached by telephone, or if the resource has accepted the offer but you still have to speak to the manager. You can directly assign your candidates to the project at a later stage, or remove them from the candidates list. As a further preliminary step to the fixed staffing of a role with resources, you can use the reservation of resources for a role. You may want to do this if you do not yet have a contract for the project or the relevant manager has not yet approved the assignment. You can decide whether a resource has been assigned or just reserved for this role using the Reserved indicator in a role staffing. You can remove this indicator if you want to change it to a fixed staffing. Depending on the role type of the relevant project role, there are three different scenarios for role staffing (or for determining candidates): ● The staffing is performed by the project lead while processing the project. A prerequisite for this scenario is that the Staffing field in the definition of the role type has the property Project Lead and that the authorizations Administration and Resource Management are assigned to the people responsible for role staffing in the corresponding project. ● Users with the authorization Staffing Manager (or Candidate Manager) in a Project Management project perform the staffing centrally in SAP Portfolio and Project Management. The Staffing field in the definition of the role type must contain Resource Manager via Authorization. ● The staffing is carried out using the extended staffing process. The Staffing field in the definition of the role type must contain Resource Manager via Responsible Organization . In the first scenario, the role staffing is carried out for individual Project Management projects, and a cross-project view is not possible. However, in many companies, resources are managed by central organizational units or resource managers. In these cases, functions are required for cross-project and cross-resource staffing. SAP Portfolio and Project Management has fast entry screens for this purpose. There are two fast entry screens, Resources Overview and Staffing Overview. Lesson: Resource Planning © Copyright. All rights reserved. 175
184.
7/26/2020 SAP e-book 1/1 Fast

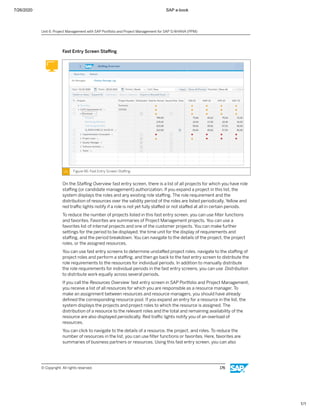

Entry Screen Staffing Figure 96: Fast Entry Screen Staffing On the Staffing Overview fast entry screen, there is a list of all projects for which you have role staffing (or candidate management) authorization. If you expand a project in this list, the system displays the roles and any existing role staffing. The role requirement and the distribution of resources over the validity period of the roles are listed periodically. Yellow and red traffic lights notify if a role is not yet fully staffed or not staffed at all in certain periods. To reduce the number of projects listed in this fast entry screen, you can use filter functions and favorites. Favorites are summaries of Project Management projects. You can use a favorites list of internal projects and one of the customer projects. You can make further settings for the period to be displayed, the time unit for the display of requirements and staffing, and the period breakdown. You can navigate to the details of the project, the project roles, or the assigned resources. You can use fast entry screens to determine unstaffed project roles, navigate to the staffing of project roles and perform a staffing, and then go back to the fast entry screen to distribute the role requirements to the resources for individual periods. In addition to manually distribute the role requirements for individual periods in the fast entry screens, you can use Distribution to distribute work equally across several periods. If you call the Resources Overview fast entry screen in SAP Portfolio and Project Management, you receive a list of all resources for which you are responsible as a resource manager. To make an assignment between resources and resource managers, you should have already defined the corresponding resource pool. If you expand an entry for a resource in the list, the system displays the projects and project roles to which the resource is assigned. The distribution of a resource to the relevant roles and the total and remaining availability of the resource are also displayed periodically. Red traffic lights notify you of an overload of resources. You can click to navigate to the details of a resource, the project, and roles. To reduce the number of resources in the list, you can use filter functions or favorites. Here, favorites are summaries of business partners or resources. Using this fast entry screen, you can also Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 176
185.
7/26/2020 SAP e-book 1/1 manually

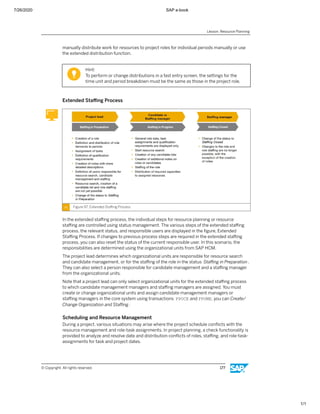

distribute work for resources to project roles for individual periods manually or use the extended distribution function. Hint: To perform or change distributions in a fast entry screen, the settings for the time unit and period breakdown must be the same as those in the project role. Extended Staffing Process Figure 97: Extended Staffing Process In the extended staffing process, the individual steps for resource planning or resource staffing are controlled using status management. The various steps of the extended staffing process, the relevant status, and responsible users are displayed in the figure, Extended Staffing Process. If changes to previous process steps are required in the extended staffing process, you can also reset the status of the current responsible user. In this scenario, the responsibilities are determined using the organizational units from SAP HCM. The project lead determines which organizational units are responsible for resource search and candidate management, or for the staffing of the role in the status Staffing in Preparation . They can also select a person responsible for candidate management and a staffing manager from the organizational units. Note that a project lead can only select organizational units for the extended staffing process to which candidate management managers and staffing managers are assigned. You must create or change organizational units and assign candidate management managers or staffing managers in the core system using transactions PPOCE and PPOME, you can Create/ Change Organization and Staffing . Scheduling and Resource Management During a project, various situations may arise where the project schedule conflicts with the resource management and role-task assignments. In project planning, a check functionality is provided to analyze and resolve date and distribution conflicts of roles, staffing, and role-task- assignments for task and project dates. Lesson: Resource Planning © Copyright. All rights reserved. 177
186.
7/26/2020 SAP e-book 1/1 You
can start the conflict overview by choosing Check Conflicts when editing a project. The conflict overview displays each single date conflict in reference to the related objects. Figure 98: Resolve Scheduling Conflicts The conflict overview provides actions to resolve the identified date conflicts, in the following ways: ● New dates are suggested to update the role and resource dates to match the planned project and task dates. ● The user can manually maintain dates in the overview to solve identified conflicts. Planned project and task dates are not changed by conflict handling. By adjusting the dates, the current dates are replaced and the conflicts are solved. By adjusting the dates and the distribution, both the dates and the distribution are adjusted to solve the conflicts. Equal distribution of the original demand is completed in the new timeframe. LESSON SUMMARY You should now be able to: ● Outline roles in Project Management ● Create roles in Project Management ● Outline the configuration of a project role type ● Outline a business partner ● Create a business partner in SAP PPM ● Check a business partner in SAP S/4HANA ● Create a resource pool Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 178
187.
7/26/2020 SAP e-book 1/1 ●
Staff roles ● Outline extended staffing processes ● Scheduling and Resource Management Lesson: Resource Planning © Copyright. All rights reserved. 179
188.
7/26/2020 SAP e-book 1/1 Unit
6 Lesson 5 Cost Planning and Cost Integration LESSON OBJECTIVES After completing this lesson, you will be able to: ● Cost Planning ● Costing configuration Cost Planning Business Scenario As a project manager, you have defined the structure of the project and have performed scheduling and resource planning. You need a detailed cost planning before you receive approval to perform the project. You want to calculate the costs of product development based on the assigned resources and their required capacity. For this reason, you require the following knowledge: ● An understanding of cost planning with Project Management ● An understanding of costing ● An understanding of how to check cost/revenue rates ● An understanding of how to check cost/revenue rates ● An understanding of plan costs in Project Management © Copyright. All rights reserved. 180
189.
7/26/2020 SAP e-book 1/1 Figure
99: Cost Planning SAP Project Management allows integration of cost planning into Accounting in an SAP S/ 4HANA or SAP ERP system. This integration takes usually place using multilevel controlling in SAP Project System (PS) to match the project structure. Single-object controlling using internal orders is also possible. In the first case, all the costs for a project are collected in a Project System project with Work Breakdown Structure (WBS) that matches the structure of the project or the project roles. Using internal orders enables the cost collection to one or several internal orders. However, the internal orders show no detailed structures like WBS elements. The WBS elements and internal orders are used as cost collectors. They provide accounting for actual and planned costs of the project from SAP Project Management. The automatic operation for generating the cost collector is called transfer. The figure, Overview of Cost Planning, shows the most important methods of integrating accounting with SAP Project Management. You can manually assign a cost collector. To do this, you must first create a cost collector in SAP ERP. The accounting integration can be started by setting the corresponding system status to transfer or assignment in the project definition. If you use accounting integration, you can start costing from SAP Project Management directly. You can save the costing in CO or in PS. You can display the cost planning in SAP Project Management. Costing is based on the required capacity that is planned in SAP Project Management. You can consider the required capacity according to tasks or project roles. You can use manual costing items such as material items to provide details about the costing. If you want to confirm activities using CATS, the actual effort is updated in the cost collector in the SAP system and the tasks or project roles of SAP Project Management. Lesson: Cost Planning and Cost Integration © Copyright. All rights reserved. 181
190.
7/26/2020 SAP e-book 1/1 Figure
100: Accounting Integration in SAP Project Management The figure, Accounting Integration in SAP Project Management, provides you with an overview of the controlling methods in SAP Project Management. The corresponding scenario is determined by assigning one to the project profile. Costing Costing Costing in SAP Project Management is performed on the basis of the project roles or the tasks. In resource planning, you can assign the required capacity to the individual project roles or to the individual tasks during the planning of the project structure. To determine the planned costs and planned revenue, multiply the required capacity by the cost and revenue rates. Figure 101: Costing Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 182
191.
7/26/2020 SAP e-book 1/1 The
figure, Costing, shows the maintenance of the cost/revenue rates in the costing view in resource planning. The cost and revenue rates were previously determined in Customizing for SAP Project Management. If the project roles are not yet staffed, the cost and revenue rates of the project roles are used for the costing. If the project role is partially staffed by a resource, the partial cost and revenue rates are used for the costing. You can find information about the costing logic in the SAP Help Portal under Costing Logic. Figure 102: Costing in SAP Project Management in detail The figure, Costing in SAP Project Management in Detail, shows the result of costing in SAP Project Management. The data is saved in SAP Project Management. However, when the cost collector is generated by a transfer or is account-assigned to a project element or project role manually, the costing data is saved in the SAP accounting system. In this case, the system displays a Calculate button that you can choose to calculate the cost collector using Easy Cost Planning (ECP). ECP is a planning method in the SAP system that also works without SAP Project Management. However, it is the preferred method for Project Management to be able to calculate the costs from the work in the project. Cost integration to SAP S/4HANA accounting Cost Transfer to SAP S/4HANA The term 'transfer' refers to the automatic creation of a cost collector. The cost collector may be a project with Work Breakdown Structure (WBS) elements or a single CO order. An alternative to the automatic creation of a cost collector is to use an already existing created cost collector before and assign it to the project for calculation. The transfer of a project with WBS is described here (multilevel controlling). However, this information also applies for single-level controlling. The time of the transfer and the type of the generated cost collector depend on the project type. During the first transfer, the SAP system generates an internal order or WBS elements. The figure, Generated and Assigned Cost Collector in SAP Project Management - Detail Screen, shows the detail data of an automatically generated internal order as it is displayed in SAP Project Management. Lesson: Cost Planning and Cost Integration © Copyright. All rights reserved. 183
192.

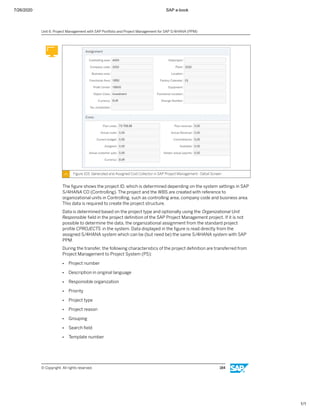

7/26/2020 SAP e-book 1/1 Figure
103: Generated and Assigned Cost Collector in SAP Project Management - Detail Screen The figure shows the project ID, which is determined depending on the system settings in SAP S/4HANA CO (Controlling). The project and the WBS are created with reference to organizational units in Controlling, such as controlling area, company code and business area. This data is required to create the project structure. Data is determined based on the project type and optionally using the Organizational Unit Responsible field in the project definition of the SAP Project Management project. If it is not possible to determine the data, the organizational assignment from the standard project profile CPROJECTS in the system. Data displayed in the figure is read directly from the assigned S/4HANA system which can be (but need be) the same S/4HANA system with SAP PPM. During the transfer, the following characteristics of the project definition are transferred from Project Management to Project System (PS): ● Project number ● Description in original language ● Responsible organization ● Priority ● Project type ● Project reason ● Grouping ● Search field ● Template number Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 184
193.

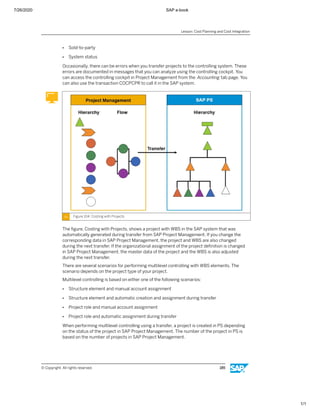

7/26/2020 SAP e-book 1/1 ●
Sold-to-party ● System status Occasionally, there can be errors when you transfer projects to the controlling system. These errors are documented in messages that you can analyze using the controlling cockpit. You can access the controlling cockpit in Project Management from the Accounting tab page. You can also use the transaction COCPCPR to call it in the SAP system. Figure 104: Costing with Projects The figure, Costing with Projects, shows a project with WBS in the SAP system that was automatically generated during transfer from SAP Project Management. If you change the corresponding data in SAP Project Management, the project and WBS are also changed during the next transfer. If the organizational assignment of the project definition is changed in SAP Project Management, the master data of the project and the WBS is also adjusted during the next transfer. There are several scenarios for performing multilevel controlling with WBS elements. The scenario depends on the project type of your project. Multilevel controlling is based on either one of the following scenarios: ● Structure element and manual account assignment ● Structure element and automatic creation and assignment during transfer ● Project role and manual account assignment ● Project role and automatic assignment during transfer When performing multilevel controlling using a transfer, a project is created in PS depending on the status of the project in SAP Project Management. The number of the project in PS is based on the number of projects in SAP Project Management. Lesson: Cost Planning and Cost Integration © Copyright. All rights reserved. 185
194.
7/26/2020 SAP e-book 1/1 The
figure, Costing with Projects, shows the account assignment between the structure elements in SAP Project Management and the WBS elements in PS. SAP Project Management only transfers WBS elements up to the third level. WBS elements in PS do not display the time frame and sequence of the tasks of SAP Project Management. WBS elements that are created automatically during the transfer receive the status Master data locked (MDLK). This ensures that no inconsistencies arise between the project in SAP Project Management and the project in PS. Note: SAP Note 954151 describes the hierarchy of PS projects created automatically based on structure elements. If the PS project was created by a transfer, you have the option of changing to the manual account assignment scenario for the corresponding SAP Project Management project. However, you cannot change the scenario in the opposite direction. Besides the automatic generation of an individual project for each project definition based on the hierarchy of phases and tasks, there are additional scenarios for accounting integration with projects. Costs can also be displayed according to the project roles. In both cases, the account assignment can also be performed manually. Alternatively, one single or several internal orders can be used for the account assignment. An alternative to the scenario with automatic transfer is the manual assignment of an SAP Project Management project to an existing PS project. In this case, you choose a project definition in PS and manually perform the account assignment to WBS elements. The account assignment can be to any WBS element. Therefore, the hierarchy of the SAP Project Management project may be different from the PS project hierarchy. You can also switch from automatic assignment to manual assignment. However, in that case the PS project WBS is no longer updated automatically. Also, it is not possible to switch back from manual assignment to automatic assignment. Note: You can assign an individual object from SAP Project Management to only one WBS element. However, you can assign several objects from SAP Project Management to the same WBS element. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 186
195.
7/26/2020 SAP e-book 1/1 Project
Cost Planning Figure 105: Cost Integration of Project Management – Possible Scenarios Cost planning in Project Management is either based on tasks or role demand. To calculate the planned costs, cost rates are multiplied by the planned work of the individual tasks or the demand of roles. The rates are defined in Customizing for Project Management, depending on organizational units and validity periods. Planning of further costs, such as the consumption of material, is not possible in Project Management without linking to one or more Controlling objects in an assigned FI/CO system. You cannot post actual costs or perform period-end closing activities in objects directly in Project Management. You can only do this in linked Controlling objects in an FI/CO system. The cost integration of Project Management supports various scenarios for linking Project Management projects with controlling objects in FI/CO systems. The figure, Cost Integration of Project Management — Possible Scenarios, displays the various scenarios. During the cost integration of Project Management, either the demand or staffing of roles, or the work for tasks is transferred to Controlling objects of an FI/CO system. During the transfer, cost elements, activity types, and cost center information are added to the data. The transfer generates costing items for internal activities in the Controlling objects in an Easy Cost Planning (ECP) costing. In a FI/CO system, you can add costing items for material, external procurements, and services or additional variable items to the ECP costing. Overhead rates can be automatically determined in ECP based on the planned costs. During the realization phase, the Controlling objects in the FI/CO system are also used to post commitments and actual costs or manage budgets. Internal orders or work breakdown structure elements (WBS elements) can be used as controlling objects in the FI/CO system. The use of WBS elements has a particular advantage: you can use multilevel controlling functions, such as the multilevel assignment of budgets or aggregated evaluation of costs in your project management. After linking one or more controlling objects with a Project Management project, you can display various controlling object data directly in the Project Management project. If required, you can navigate directly from Project Management to the processing of controlling objects in Lesson: Cost Planning and Cost Integration © Copyright. All rights reserved. 187
196.
7/26/2020 SAP e-book 1/1 the
FI/CO system to manually add costing items to the ECP costing. In addition, you can call detailed reports for the controlling objects. Cost Planning Configuration You must make specific settings in Customizing to enable Accounting Integration in SAP Project Management. You must carry out the following Customizing steps: 1. Activate integration: Define if the accounting integration is active and when the integration occurs, for example, when there is a status change in the project definition. 2. Define object links for accounting integration : Define the object link that is used for accounting integration. In the standard system, tow entries are already defined — one for internal orders and one for WBS elements. In the object link, you also have to define the shown fields from the cost collector, the RFC connection and logical system used, and the services available through SAP WebGUI. 3. Make General Settings: Determine the look of the overview screen per project type in the accounting section of SAP Project Management. The object type is relevant for the link. 4. Define Cost and Revenue Rates: Define the cost and revenue rates of the tasks and the project roles for SAP Project Management. 5. Replicate Cost and Revenue rates : The cost and revenue rates are replicated to a connected S/4HANA Controlling system for cost calculation, where the internal orders or WBS elements are created. 6. Replicate accounting-relevant characteristics : The project types and project reasons are replicated to the SAP S/4HANA Controlling system. 7. Make settings in S/4HANA system : Make accounting-relevant settings in SAP S/4HANA of the internal orders and WBS elements. For example, you can assign cost and revenue rates to cost elements, activity types, and revenue elements in SAP S/4HANA. You specify the controlling methods that you want to use for accounting integration. For the Internal Order (Project Definition, Automatic) scenario, the order type CPR1 is delivered in the standard system with the sample order $CPR1 in SAP Controlling (CO). For the Multilevel Controlling (Structure Element, Automatic) and Multilevel Controlling (Project Role, Automatic) scenarios, you require the project profile CPR0001. This profile is not contained in the standard system; you must create it. If the configuration options using the profile described are insufficient, there are various Business Add-Ins (BAdIs) that you can use to control the system behavior during the transfer. The BAdIs that you can use to influence system behavior during the transfer are as follows: ● Additional attributes for replication using single-object controlling You can transfer additional characteristics to the accounting interface. You can update these characteristics in accounting in the controlling object or in the settlement rule. You can also use this method to change standard characteristics. ● Change costing data for single-object controlling You can manually change the costs and revenues on which costing is based. In addition, you can divide or group together the costing rows. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 188
197.
7/26/2020 SAP e-book 1/1 ●
Enhancement for manual multilevel controlling You can specify default values for assigning WBS elements to SAP Project Management project elements. This action saves the project manager or the controller from performing a lengthy manual assignment. You can find further information in the Configuration Guide for Project Management. You can download the configuration guide from the SAP Help Portal. LESSON SUMMARY You should now be able to: ● Cost Planning ● Costing configuration Lesson: Cost Planning and Cost Integration © Copyright. All rights reserved. 189
198.
7/26/2020 SAP e-book 1/1 Unit
6 Lesson 6 Project Execution LESSON OBJECTIVES After completing this lesson, you will be able to: ● Status management and project release ● Confirmation of activities in projects ● Approval process of phases in projects Project Execution The execution of projects in Project Management starts with the release of the project definition. The release of the project definition is inherited by the first phase and its subordinate objects, such as tasks, subtasks, checklists, and checklist items. Subsequent phases are released gradually (and manually) in the course of the project when the previous phases are completed. However, you can also release tasks, checklists, or individual checklist items of subsequent phases even if the phase has not been released. The release of tasks and checklist items is a prerequisite for the creation of confirmation data for these objects. You can enter the actual start date, actual end date, work carried out, percentage of work completed, and (if necessary), you can manually enter the remaining work for this task. If you use the time sheet for the confirmation, you can enter actual dates and actual work for tasks in Project Management. In addition, you can post actual costs to the respective controlling objects in FI/CO. When confirming checklist items, you can enter the checklist item result OK, Not OK, or Not relevant. If the processing of tasks and checklist items finishes, you can document this by setting the status Completed. The completion of a phase in Project Management can be linked to an approval procedure that ensures all planned targets of the phase have been reached. The approval procedure of a phase is triggered by the user responsible for the phase after completing all approval-relevant tasks and checklist items. The user responsible for a phase determines which individual decision-maker approves the phase, creates an approval document with all information relevant for the approval, and starts the approval. Based on the approval document, the individual decision maker can approve or reject a phase accordingly. The total approval of a phase and the completion of a phase is performed by the person responsible for the phase. During a project, you can regularly create project status reports, which contain basic information about the current status of the project. For informational purposes, these project status reports can be sent to the relevant users responsible for the project. In the course of the project, if exceptions (threshold value violations) occur in structure elements of the Project Management project or in the linked objects in back-end systems, you can flag the structure elements in Project Management. Using alert management, the relevant users can be automatically informed about exceptions by e-mail. © Copyright. All rights reserved. 190
199.

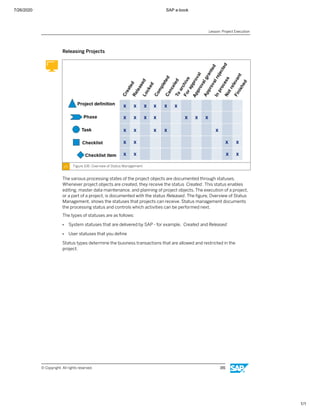

7/26/2020 SAP e-book 1/1 Releasing
Projects Figure 106: Overview of Status Management The various processing states of the project objects are documented through statuses. Whenever project objects are created, they receive the status Created. This status enables editing, master data maintenance, and planning of project objects. The execution of a project, or a part of a project, is documented with the status Released. The figure, Overview of Status Management, shows the statuses that projects can receive. Status management documents the processing status and controls which activities can be performed next. The types of statuses are as follows: ● System statuses that are delivered by SAP - for example, Created and Released ● User statuses that you define Status types determine the business transactions that are allowed and restricted in the project. Lesson: Project Execution © Copyright. All rights reserved. 191
200.

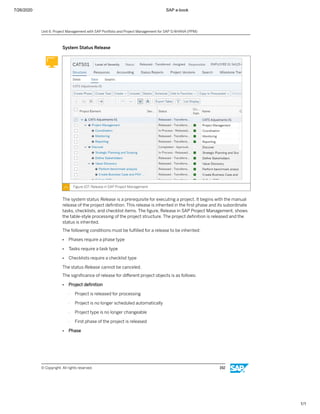

7/26/2020 SAP e-book 1/1 System
Status Release Figure 107: Release in SAP Project Management The system status Release is a prerequisite for executing a project. It begins with the manual release of the project definition. This release is inherited in the first phase and its subordinate tasks, checklists, and checklist items. The figure, Release in SAP Project Management, shows the table-style processing of the project structure. The project definition is released and the status is inherited. The following conditions must be fulfilled for a release to be inherited: ● Phases require a phase type ● Tasks require a task type ● Checklists require a checklist type The status Release cannot be canceled. The significance of release for different project objects is as follows: ● Project definition - Project is released for processing - Project is no longer scheduled automatically - Project type is no longer changeable - First phase of the project is released ● Phase Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 192
201.

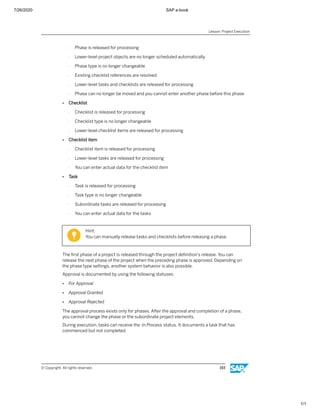

7/26/2020 SAP e-book 1/1 -
Phase is released for processing - Lower-level project objects are no longer scheduled automatically - Phase type is no longer changeable - Existing checklist references are resolved - Lower-level tasks and checklists are released for processing - Phase can no longer be moved and you cannot enter another phase before this phase ● Checklist - Checklist is released for processing - Checklist type is no longer changeable - Lower-level checklist items are released for processing ● Checklist item - Checklist item is released for processing - Lower-level tasks are released for processing - You can enter actual data for the checklist item ● Task - Task is released for processing - Task type is no longer changeable - Subordinate tasks are released for processing - You can enter actual data for the tasks Hint: You can manually release tasks and checklists before releasing a phase. The first phase of a project is released through the project definition's release. You can release the next phase of the project when the preceding phase is approved. Depending on the phase type settings, another system behavior is also possible. Approval is documented by using the following statuses: ● For Approval ● Approval Granted ● Approval Rejected The approval process exists only for phases. After the approval and completion of a phase, you cannot change the phase or the subordinate project elements. During execution, tasks can receive the In Process status. It documents a task that has commenced but not completed. Lesson: Project Execution © Copyright. All rights reserved. 193
202.
7/26/2020 SAP e-book 1/1 When
a project definition, phase, or task is completed successfully, this is documented with the Closed status. Once the Closed status has been achieved, the project objects cannot be changed. However, you can reset the status. If a checklist or a checklist item is completed successfully, this is documented by the status Finish. Confirming Projects As a project manager, you want employees to document their tasks by confirming their working hours and dates. This information provides you with an overview of how the project is progressing, and enables you to identify any inconsistencies early on. For this reason, you require the following knowledge: ● An understanding of how to confirm tasks ● An understanding of how to confirm tasks with the Cross-Application Time Sheet (CATS) ● An understanding of how to confirm checklist items Task Confirmation You can use confirmations to document the processing status of project elements and enter the current data for project elements. In Project Management, you can confirm tasks and checklist items. However, you can only enter confirmations if the task or the checklist item has the status Released or In Process. You can enter the actual start, actual work, actual finish, percentage of completion, and status. You can open tasks, notes, and documents. You can copy planned dates to actual dates. You can confirm the following data for each task: ● Actual work ● Actual start date ● Actual finish date ● Remaining work ● Percentage of completion There are also alternatives for confirming tasks: ● You can enter the actual data directly in the detail screen of a task ● You can use the tabular view displayed in the figure ● You can use the CATS integration To enter the confirmation data directly in the tasks detail screen, choose the Dates and Work tab page. On this tab page, you can enter working hours and the percentage of completion. The remaining work is the difference between the planned work and the actual work. If you select the Remaining work manually checkbox, the system does not calculate the remaining work, and you can enter it directly. The percentage of completion is independent of the planned work, actual work, or remaining work. Besides work, you also specify the actual start date and the actual finish date. When you execute a task, you can also set the In Process status. This indicates that the task has begun but has not been finished. The In Processing status is set in addition to the Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 194
203.
7/26/2020 SAP e-book 1/1 Released
status. When the task is completed, you can set the Closed status. When the Closed status is set, you can no longer change the confirmed data, however, you can reset the status. The Canceled status is used when a task is terminated. If this status is set as Canceled, you can no longer change the task, and any relationships to other tasks are deleted. The figure shows the confirmation of tasks in a tabular view. The advantage of this view is that you can confirm tasks for multiple projects together. You can confirm actual dates and working hours, add documents, and copy planned dates to actual dates. Hint: As an alternative to time recording of tasks, you can also post working hours relating to project roles. To do this, the project type must be configured accordingly. An additional checkbox controls whether you can enter additional time for the project definition. Task Confirmation with CATS (Cross-Application Time Sheet) Figure 108: Time Recording Using CATS You can use CATS to enter the working time for tasks or project roles from SAP Project Management. If prerequisites are applied, the worklist in the time sheet is filled with the tasks and roles that are assigned to a user or the users for which they are responsible. Tasks and roles are selected from the worklist and their respective working time is entered. These working times are transferred to SAP Project Management and are available for reporting. These working times are also updated in the account assignment objects in accounting integration. This means the actual costs are updated in the internal order or on the work breakdown structure (WBS) element that is assigned to the project element. The figure, Time recording using CATS , provides you with an overview of the individual steps for time recording using the time sheet. Lesson: Project Execution © Copyright. All rights reserved. 195
204.
7/26/2020 SAP e-book 1/1 Hint: You
must use a worklist in CATS to enter times for SAP Project Management. You can only enter times for project elements that are contained in the worklist. Time Recording with CATS2 The following prerequisites must apply to enable time data entry on the time sheet: ● In SAP Project Management, the project type must allow time recording with CATS. ● Accounting integration must be active for the project. ● You must have performed resource planning and staffing for the projects. ● A personnel number must be assigned to the business partner. ● If the Project Management system and the system for CATS are not identical, you must set up an Application Link Enabling (ALE) connection between both systems. ● A suitable data entry profile must be set for the time sheet. ● If you want to edit detail information (such as remaining work), in the transaction CAT2, you have to activate the CA_CATS_CPR_CORE business function in the Switch Framework (transaction code SFW5). This business function is shipped with enhancement package 3 for SAP ERP. Hint: SAP Note 954860 describes how you can set up the ALE connection. SAP Note 913347 describes a scenario where SAP Project Management and CATS are installed on the same system. The entered times and the associated costs are transferred to accounting using the transaction CATA. For SAP Project Management, you transfer the data manually by using the DPR_CATS_CPR_TRANSF report. During the transfer, the actual start date is also transferred. The earliest actual start date is saved on the project element. The confirmation entered in CATS does not change the status of the project element. CATS are also available in a web based user interface. This improves usability and provides a unique and seamless interface. In this case, a worklist can also be used to identify possible objects to record times. Furthermore, a calender is provided to support users with already recorded times, as well as working days. Checklist item confirmation You can also enter confirmations for checklist items. Unlike tasks, you cannot specify the actual work, the remaining work, or the percentage of completion for checklist items. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 196
205.

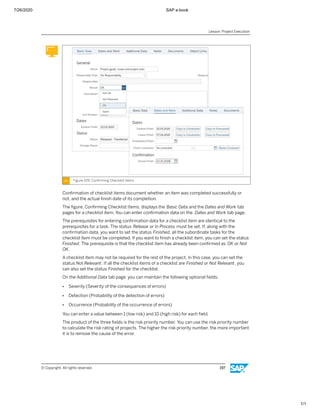

7/26/2020 SAP e-book 1/1 Figure
109: Confirming Checklist Items Confirmation of checklist items document whether an item was completed successfully or not, and the actual finish date of its completion. The figure, Confirming Checklist Items, displays the Basic Data and the Dates and Work tab pages for a checklist item. You can enter confirmation data on the Dates and Work tab page. The prerequisites for entering confirmation data for a checklist item are identical to the prerequisites for a task. The status Release or In Process must be set. If, along with the confirmation data, you want to set the status Finished, all the subordinate tasks for the checklist item must be completed. If you want to finish a checklist item, you can set the status Finished. The prerequisite is that the checklist item has already been confirmed as OK or Not OK. A checklist item may not be required for the rest of the project. In this case, you can set the status Not Relevant. If all the checklist items of a checklist are Finished or Not Relevant, you can also set the status Finished for the checklist. On the Additional Data tab page, you can maintain the following optional fields: ● Severity (Severity of the consequences of errors) ● Detection (Probability of the detection of errors) ● Occurrence (Probability of the occurrence of errors) You can enter a value between 1 (low risk) and 10 (high risk) for each field. The product of the three fields is the risk priority number. You can use the risk priority number to calculate the risk rating of projects. The higher the risk priority number, the more important it is to remove the cause of the error. Lesson: Project Execution © Copyright. All rights reserved. 197
206.

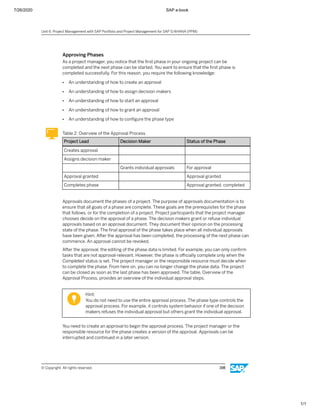

7/26/2020 SAP e-book 1/1 Approving
Phases As a project manager, you notice that the first phase in your ongoing project can be completed and the next phase can be started. You want to ensure that the first phase is completed successfully. For this reason, you require the following knowledge: ● An understanding of how to create an approval ● An understanding of how to assign decision makers ● An understanding of how to start an approval ● An understanding of how to grant an approval ● An understanding of how to configure the phase type Table 2: Overview of the Approval Process Project Lead Decision Maker Status of the Phase Creates approval Assigns decision maker Grants individual approvals For approval Approval granted Approval granted Completes phase Approval granted, completed Approvals document the phases of a project. The purpose of approvals documentation is to ensure that all goals of a phase are complete. These goals are the prerequisites for the phase that follows, or for the completion of a project. Project participants that the project manager chooses decide on the approval of a phase. The decision makers grant or refuse individual approvals based on an approval document. They document their opinion on the processing state of the phase. The final approval of the phase takes place when all individual approvals have been given. After the approval has been completed, the processing of the next phase can commence. An approval cannot be revoked. After the approval, the editing of the phase data is limited. For example, you can only confirm tasks that are not approval-relevant. However, the phase is officially complete only when the Completed status is set. The project manager or the responsible resource must decide when to complete the phase. From here on, you can no longer change the phase data. The project can be closed as soon as the last phase has been approved. The table, Overview of the Approval Process, provides an overview of the individual approval steps. Hint: You do not need to use the entire approval process. The phase type controls the approval process. For example, it controls system behavior if one of the decision makers refuses the individual approval but others grant the individual approval. You need to create an approval to begin the approval process. The project manager or the responsible resource for the phase creates a version of the approval. Approvals can be interrupted and continued in a later version. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 198
207.
7/26/2020 SAP e-book 1/1 Figure
110: Assigning Decision Makers to the Approval You need to assign decision makers to the approval. The project manager specifies the decision makers for the approval. The decision makers are the people that grant or reject individual approvals. The figure, Assigning Decision Makers to the Approval, shows the assignment of decision makers to an approval. The project manager selects a project role and then assigns the people staffed to this project role as the decision maker. A prerequisite for acceptance is therefore resource planning plus the staffing of the project roles. Start of Approval You can now start the approval. When the approval begins, the system generates an approval document with the relevant data of the phase. For the decision makers, the approval document appears under Approvals on the initial Project Management screen. After the approval begins, the statuses of the phase are Release and For Approval . Lesson: Project Execution © Copyright. All rights reserved. 199
208.
7/26/2020 SAP e-book 1/1 Figure
111: Granting Individual Approval The decision maker needs to grant individual approvals. With an individual approval, each individual decision maker decides whether the planned results of a phase have been achieved. The figure, Granting Individual Approval, shows how a decision maker grants an individual approval. The decision maker can add a comment to the approval, grant or reject it. In this case, the decision makers need to authenticate themselves. They do this by entering their password. Depending on the system settings, a digital signature can be used as a means of authentication. The individual approval does not change the status of the phase. Hint: Before the data transfer, the decision can be changed with the Change Decision button. When authentication has taken place and has been accepted, it cannot be changed. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 200
209.
7/26/2020 SAP e-book 1/1 Figure
112: Grant Approval You need to grant the approval. The project manager approves the complete phase. Ideally, all individual approvals must be given first. The figure, Grant Approval, shows how approval is granted for a phase. The project manager only needs to choose the corresponding button. The phase then has the Released and the Approval Granted status. The approval cannot be revoked. Processing of the phase data is still possible to a limited extent. Approving the phase can release the successor phase for execution. The actual phase is completed by setting the status of the phase to Completed. This step can also be automated by making corresponding settings for the phase type. After you have set the status of a phase to Completed, you can no longer change it. Note: This lesson explains the ideal approval process. It assumes that all individual approvals are granted, and that the approval is not canceled and needs to be resumed. The lesson does not consider different approval versions. Phase Type You can define the phase type on the Basic Data tab page of a phase. The phase type profile in Customizing describes the approval process of a phase and its effects on the other phases. For example, the phase type can determine that an approval process is to be carried out and that the successor phase can only be released after the predecessor phase has been approved. Lesson: Project Execution © Copyright. All rights reserved. 201
210.
7/26/2020 SAP e-book 1/1 Figure
113: Phase Type You can define the phase type on the Basic Data tab page of a phase. The phase type profile in Customizing describes the approval process of a phase and its effects on the other phases. For example, the phase type can determine that an approval process is to be carried out and that the successor phase can only be released after the predecessor phase has been approved. The checkboxes and fields for the phase type have the following meanings: ● Approve Phase: If this checkbox is selected, an approval must be carried out for the phase. ● Print Form for Approval Document : This field defines the layout and the contents of the approval document. If you specify an invalid print form or no print form, the system uses the SAP standard form, DPR_APPROVAL. If this form is not active, you cannot start an approval. ● Assign Decision Maker at Beginning - Assign Decision Maker: You can, at the start of the approval, enter project roles as decision makers for which you have not yet chosen a person. In such cases, the system automatically chooses the assigned person. If several persons are assigned to the project role, the system transfers the person to which the role is assigned at the end of the phase. - Do Not Assign Decision Maker: You must assign the decision maker manually before you can start the approval. ● Changeability of Ind. Approval Aft. Begin : This checkbox defines whether you are allowed to add or delete decision makers after the approval has started, but before it has been completed. Note that you can only delete individual approvals if no decision has been made. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 202
211.

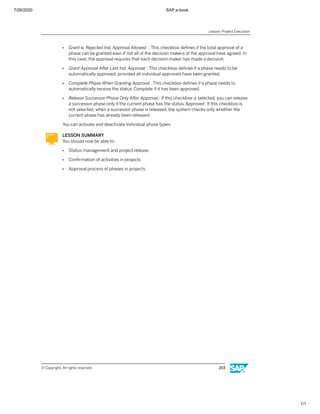

7/26/2020 SAP e-book 1/1 ●
Grant w. Rejected Ind. Approval Allowed : This checkbox defines if the total approval of a phase can be granted even if not all of the decision makers of the approval have agreed. In this case, the approval requires that each decision maker has made a decision. ● Grant Approval After Last Ind. Approval : This checkbox defines if a phase needs to be automatically approved, provided all individual approvals have been granted. ● Complete Phase When Granting Approval : This checkbox defines if a phase needs to automatically receive the status Complete if it has been approved. ● Release Successor Phase Only After Approval : If this checkbox is selected, you can release a successor phase only if the current phase has the status Approved. If this checkbox is not selected, when a successor phase is released, the system checks only whether the current phase has already been released. You can activate and deactivate individual phase types. LESSON SUMMARY You should now be able to: ● Status management and project release ● Confirmation of activities in projects ● Approval process of phases in projects Lesson: Project Execution © Copyright. All rights reserved. 203
212.
7/26/2020 SAP e-book 1/1 Unit
6 Lesson 7 Project Evaluation LESSON OBJECTIVES After completing this lesson, you will be able to: ● Reporting in SAP S/4HANA Project Management Evaluating Projects As a project manager, you need to find out the status of your project. You also need to record the status of the project and comment on it. For this reason, you require the following knowledge: ● How to evaluate a project ● How to configure reports ● How to create a project status report Evaluations provide you with an overview of the data of your project. You can use the current project data as the basis, or the last version of the data that was stored in the background. You can create evaluations for operational projects and for project versions. Figure 114: Evaluation of Completed Checklist Items The evaluations delivered with SAP Project Management are as follows: ● Tasks and task assignment ● Completed checklist items © Copyright. All rights reserved. 204

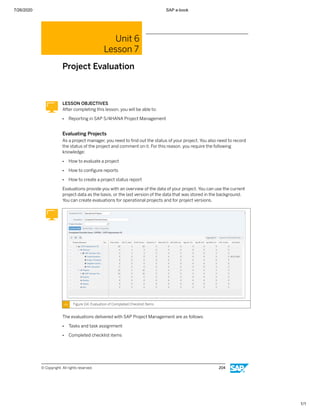

213.

7/26/2020 SAP e-book 1/1 ●
Completed documents ● Project resources and project role staffing ● Project roles and project role staffing ● SAP ERP objects ● SAP ERP project progress ● SAP ERP project costs and revenues ● Project dates with SAP ERP objects ● Deadlines and expenses ● Project element-orientated costs ● Cost and revenue costing for project The figure, Evaluation of Completed Checklist Items, shows the evaluation of completed checklist items. The left section contains a navigation area similar to the navigation area in project maintenance. The right section shows columns with data for the respective project object. In this specific case, you see an overview of the mandatory checklist items that have already been completed. All project elements are not displayed in the navigation area of the report. This report does not display tasks and checklist items. Project elements and the number of columns are defined in the evaluation settings in Customizing for PPM. You can export the data of an evaluation to display it in a spreadsheet. The figure shows the options for exporting reports. The system exports data in the Comma Separated Values (CSV) format and saves it in a file or opens it directly in Microsoft Excel. Additional icons can appear in the navigation area of an evaluation. These icons indicate special features or discrepancies in the project. They are defined as threshold values or severity levels in the system. If a threshold value is exceeded, the system displays a corresponding symbol to warn you. Regarding threshold values, the system can create e-mail notifications called alerts. Report Configuration Evaluations are included in the standard system. They are defined as evaluation layouts in Customizing for PPM. You can also create your own evaluations using your own evaluation layouts. Overview of Settings ● Attributes: Approximately 129 attributes, for example, Actual_Finish. ● Objects: Approximately 10 objects for attributes, for example, checklist items and tasks. ● Extract layouts: Approximately 11 extract layouts, with certain attributes for certain objects, for example, 0_Project_Compl. ● Iterators: 4 iterators determined by SAP, for example, a project. These determine the hierarchical structure of the extract layout. ● Evaluation Layouts: Approximately 11 evaluation layouts, for example , 0_Project_Clitem is related to a certain extract layout with certain attributes for certain objects. Lesson: Project Evaluation © Copyright. All rights reserved. 205
214.

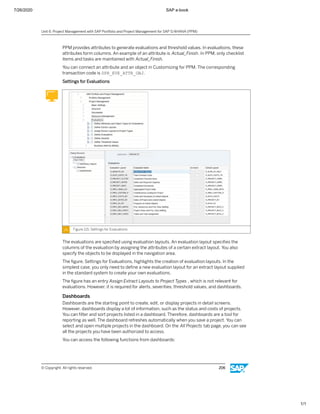

7/26/2020 SAP e-book 1/1 PPM
provides attributes to generate evaluations and threshold values. In evaluations, these attributes form columns. An example of an attribute is Actual_Finish. In PPM, only checklist items and tasks are maintained with Actual_Finish. You can connect an attribute and an object in Customizing for PPM. The corresponding transaction code is DPR_EVE_ATTR_OBJ. Settings for Evaluations Figure 115: Settings for Evaluations The evaluations are specified using evaluation layouts. An evaluation layout specifies the columns of the evaluation by assigning the attributes of a certain extract layout. You also specify the objects to be displayed in the navigation area. The figure, Settings for Evaluations, highlights the creation of evaluation layouts. In the simplest case, you only need to define a new evaluation layout for an extract layout supplied in the standard system to create your own evaluations. The figure has an entry Assign Extract Layouts to Project Types , which is not relevant for evaluations. However, it is required for alerts, severities, threshold values, and dashboards. Dashboards Dashboards are the starting point to create, edit, or display projects in detail screens. However, dashboards display a lot of information, such as the status and costs of projects. You can filter and sort projects listed in a dashboard. Therefore, dashboards are a tool for reporting as well. The dashboard refreshes automatically when you save a project. You can select and open multiple projects in the dashboard. On the All Projects tab page, you can see all the projects you have been authorized to access. You can access the following functions from dashboards: Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 206
215.
7/26/2020 SAP e-book 1/1 ●
Edit projects ● Create projects ● Compare projects ● Import and export projects ● Export dashboard to Microsoft Excel ● Search for projects ● Filter ● User-defined setting for columns, sort, and filter of projects Project Status Report You can use project status reports to record important project data and comment on it at any time. Project status reports can be sent as e-mail attachments. Figure 116: Project Status Report Project status reports are based on Adobe Interactive Forms (AIF). Project status reports are displayed in a report folder within the project. In addition to project status reports, you can also assign additional documents here. The figure, Project Status Report, shows the creation of a report in SAP Project Management. To edit a project, you can navigate to the Status Reports tab page. Depending on the project type, you can choose different templates for the project status report. The templates determine the procedure of the project status report. When you have selected a template, you can look at it and supplement it using Preview. You can store the report in SAP Project Management, or by using the SAP Document Management System (SAP DMS) of the SAP system. You define the type of storage in the project type in Customizing for SAP Project Management. Project status reports are structured hierarchically. The report folder is used to navigate between individual reports. Above the report folder, there are options to create new project status reports, send out reports, or delete them. You can use New Document to include any data that is saved on your hard disk, for example, as documents in the report folder in SAP Project Management. Project Status Report configuration The look of a project status report depends on the template that is used. The standard system contains a template that you can use immediately. The name of the template is Lesson: Project Evaluation © Copyright. All rights reserved. 207
216.
7/26/2020 SAP e-book 1/1 DPR_STATUS_REPORT_AIF.
You can use this template as a copy template for your own project status reports. The menu paths to perform the related activities are as follows: ● To create PDF-based forms, in Customizing, for SAP Portfolio and Project Management under Project Management choose,Basic Settings→ Forms for Printing and Project Status Reports→ Create PDF-based forms . ● To activate forms per project type, in Customizing, for SAP Portfolio and Project Management under Project Management choose, Basic Settings→ Forms for Printing and Project Status Reports → Activate Forms per Project Type . ● To activate business add-in for PDF-based forms, in Customizing, for SAP Portfolio and Project Management under Project Managementchoose, Basic Settings→ Forms for Printing and Project Status Reports → Business Add-Ins (BAdIs)→ Activate Forms per Project Type . When you have created a template, or have decided on a standard template, you must assign the project type. You can assign templates to the same project type. In the application, you can then choose between the various templates. Finally, you need to adjust the actual project type. For each project type, you define whether you can create project status reports, and the location to store project status reports. They are stored in SAP Project Management or in SAP DMS. You must implement a BAdI for each PDF-based template. In the standard system, a BAdI has already been implemented for DPR_STATUS_REPORT_AIF . If you prefer to save the project status reports in the DMS of an SAP system, rather than in SAP Project Management, you must make some additional settings there. The Project Management configuration guide describes these settings. Using Alerts As a project manager, you need a quick overview of the progress of the project. Reports are suitable for this. However, reading and interpreting a report is time consuming. For this reason, you require the following knowledge: ● An understanding of how to configure threshold values ● An understanding of how to trigger alerts An alert is a notification used to inform the people involved in a project of certain changes. For example, the person responsible for a checklist can be informed by e-mail that all the checklist items have been completed. The different ways of triggering alerts are as follows: ● If all the tasks of a checklist item are closed, or if all the checklist items of a checklist have been completed, the person responsible for the checklist item or the checklist receives a corresponding alert notification. ● If there is a threshold value violation for a project element, an alert is also sent to the person responsible. ● If there is a threshold value violation for an assignment, a staffing, a business partner, or an object link, alerts are also sent to the person responsible. Additional alerts can also be sent for project elements and object links if the severity is set manually, or if there is a threshold value violation for a subordinate object. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 208
217.

7/26/2020 SAP e-book 1/1 Alerts
are sent to the person responsible for the affected object. For project definitions, phases, checklists, and checklist items, the persons responsible are staffed to the role responsible for performing the tasks. For a task, however, the person responsible and the business partners who are staffed to roles of the tasks are alerted. Alerts are always checked and sent when you save the project, or when you create an evaluation. Alerts can also be triggered in connection with multi-project management. Configuring Alerts The connection between an alert and a threshold value violation is defined in Customizing for PPM. When you define the severities (not the threshold values), you can assign alert categories to severities. In SAP Project Management, use the alert category CPROJECTS_SEVERITY provided in the standard system. To send notifications, you need a recipient, that is, an e-mail address. This e-mail address is either contained in the business partner data or is taken from the user master record. The e- mail address of the business partner is used if no user is assigned to the business partner. Hint: If a user is assigned to the business partner, the system uses the e-mail address of this user. Threshold Values Project managers find symbols and traffic lights useful because they indicate special features in their projects. In SAP Project Management, this is achieved with threshold values and severities. These symbols appear as icons in the navigation area of the structure, in dashboards, and in evaluations. In SAP Project Management, threshold values are used to get quick estimates of projects. If threshold values are violated, appropriate icons are displayed in reports and in the project processing. Threshold value violations are checked in evaluations. If the object meets the requirement, the system displays an icon in the evaluation. The icon corresponds to the severity that is assigned to the threshold value. For example, a yellow traffic light can be displayed for tasks that are up to a week behind schedule. A red traffic light can be displayed for longer delays. The same icons can also be displayed in project maintenance. Threshold value violations can be triggered in the following ways: ● Manually in the project element ● Automatically in certain evaluations ● Automatically for certain project types You can manually maintain a threshold value or severity for a phase. You specify the threshold values and severities in Customizing for PPM. (No settings are maintained in the standard system.) The icon that corresponds to the severity is displayed in the navigation area. SAP Fiori applications for SAP Project Management SAP Fiori is the new user experience (UX) for SAP software that applies modern design principles. SAP solutions, such as the SAP Business Suite powered by SAP HANA, are using the SAP Fiori UX to provide a personalized, responsive, and simple user experience. Lesson: Project Evaluation © Copyright. All rights reserved. 209
218.
7/26/2020 SAP e-book 1/1 Figure

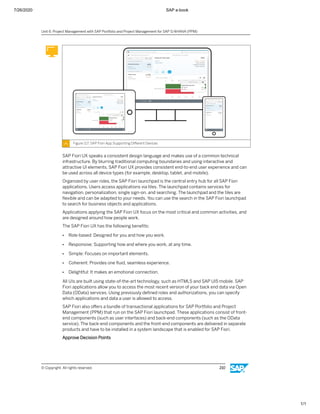

117: SAP Fiori App Supporting Different Devices SAP Fiori UX speaks a consistent design language and makes use of a common technical infrastructure. By blurring traditional computing boundaries and using interactive and attractive UI elements, SAP Fiori UX provides consistent end-to-end user experience and can be used across all device types (for example, desktop, tablet, and mobile). Organized by user roles, the SAP Fiori launchpad is the central entry hub for all SAP Fiori applications. Users access applications via tiles. The launchpad contains services for navigation, personalization, single sign-on, and searching. The launchpad and the tiles are flexible and can be adapted to your needs. You can use the search in the SAP Fiori launchpad to search for business objects and applications. Applications applying the SAP Fiori UX focus on the most critical and common activities, and are designed around how people work. The SAP Fiori UX has the following benefits: ● Role-based: Designed for you and how you work. ● Responsive: Supporting how and where you work, at any time. ● Simple: Focuses on important elements. ● Coherent: Provides one fluid, seamless experience. ● Delightful: It makes an emotional connection. All UIs are built using state-of-the-art technology, such as HTML5 and SAP UI5 mobile. SAP Fiori applications allow you to access the most recent version of your back end data via Open Data (OData) services. Using previously defined roles and authorizations, you can specify which applications and data a user is allowed to access. SAP Fiori also offers a bundle of transactional applications for SAP Portfolio and Project Management (PPM) that run on the SAP Fiori launchpad. These applications consist of front- end components (such as user interfaces) and back-end components (such as the OData service). The back-end components and the front-end components are delivered in separate products and have to be installed in a system landscape that is enabled for SAP Fiori. Approve Decision Points Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 210
219.
7/26/2020 SAP e-book 1/1 The
transactional application, Approve Decision Points, allows program managers to approve or reject a decision point at the end of a phase. Key features of the Approve Decision Points application, are as follows: ● Display a list of all assigned portfolio items with decision points for approval, for example you can display data of portfolio items and decision points. ● Group, sort, and filter entries in the portfolio items. ● Search for portfolio items in the portfolio items list. ● Approve or reject a single decision point, or multiple decision points, simultaneously. You can also add notes to explain these decisions. ● Display notes or add new notes to portfolio items. You can also contact the creators of the notes. ● Add, display, and delete attachments assigned to portfolio items. ● Share notes and attachments referring to portfolio items via SAP JAM groups to discuss with other group members. Confirm Project Tasks The transactional application, Confirm Project Tasks, allows project team members to view a list of all the project tasks to which they are assigned. They can also confirm the progress of their work. Key features of the Confirm Project Tasks application, are as follows: ● Display all project tasks to which you are assigned. ● Group or filter the entries in the list of project tasks. ● Confirm the progress of your work for a selected project task. ● Display notes or add new notes to project tasks. You can also contact the creators of notes. ● Display attachments assigned to project tasks. ● Share notes and attachments referring to project tasks via SAP JAM groups to discuss with other group members. With SAP S/4HANA SAP delivers the Fiori application My Projects - Active Projects that offers an additional overview and detail reports of the projects managed by you. Lesson: Project Evaluation © Copyright. All rights reserved. 211
220.
7/26/2020 SAP e-book 1/1 Figure

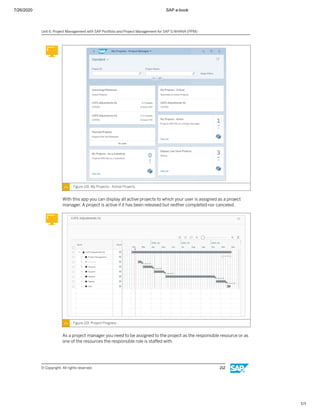

118: My Projects - Active Projects With this app you can display all active projects to which your user is assigned as a project manager. A project is active if it has been released but neither completed nor canceled. Figure 119: Project Progress As a project manager you need to be assigned to the project as the responsible resource or as one of the resources the responsible role is staffed with. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 212
221.
7/26/2020 SAP e-book 1/1 Key
Features ● Get an overview of all active projects for which you are responsible as a project manager. ● See the most important project details at a glance, such as: - Name and ID of the project: The name is displayed in the logon language, if available. Otherwise the name is displayed in the master language. If no name is available in the master language, the ID is displayed. - Type of the project - Name of the currently active phase and its planned latest finish date: If there is more than one active phase, the phase with the earliest start date is displayed. If there is more than one active phase with the same earliest start date, the phase with the smallest sort number is displayed. The name is displayed in the logon language, if available. Otherwise the name is displayed in the master language. If no name is available in the master language, the ID is displayed. - Latest date of the milestone that has been defined as the main milestone of the project: A main milestone is displayed if the corresponding task is defined as a milestone and the related task type is defined as a main milestone. - Name and planned latest finish date of the earliest upcoming or overdue milestone: An upcoming or overdue milestone is displayed if the corresponding task is defined as a milestone and the related task type is defined as a relevant milestone. The name is displayed in the logon language, if available. Otherwise the name is displayed in the master language. If no name is available in the master language, the ID is displayed. ● Drill down to further apps to display and edit the following details of a selected project:# - Project Progress - Project structure including project elements such as phases and tasks, as well as all project details, for example basic data, authorizations or assigned objects - Persons who are assigned to the project as resources and further details of staffing and resource - If the project refers to a portfolio item ■ Financial planning data ■ Capacity planning dtat ■ Details of the assigned portfolio item : ● Change the appearance of the list displayed for your user: - Search for projects in the list - Filter the list data - Sort or group the list data - Export the list data to a spreadsheet Lesson: Project Evaluation © Copyright. All rights reserved. 213
222.
7/26/2020 SAP e-book 1/1 LESSON
SUMMARY You should now be able to: ● Reporting in SAP S/4HANA Project Management Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 214
223.
7/26/2020 SAP e-book 1/1 Unit
6 Lesson 8 Project Versions LESSON OBJECTIVES After completing this lesson, you will be able to: ● Project snapshots and simulation versions Managing Project Versions You have been working on a project to develop a new product for six months. Your portfolio manager asks you for the status of the project. The portfolio manager is particularly interested in reconciliation with the original planning. For this reason, you require the following knowledge: ● How to create a version ● How to configure project versions ● How to create a snapshot of a project ● How to create a simulation of a project ● How to compare simulations and projects © Copyright. All rights reserved. 215
224.
7/26/2020 SAP e-book 1/1 Project
Versions Figure 120: Versions in SAP Project Management Project versions are copies of operational projects at a particular time. They are used for reporting or to simulate an operational project. In both cases, project data is copied to the project version. Project versions that are created for later, reconciling reporting are known as snapshots. You cannot change snapshots. Project versions in which you want to simulate the operational projects are known as simulations. You can change simulations and use them for a later comparison with the operational project. Project versions must have a unique name. To identify a project version, you need the name of the project and the version number. You must define valid versions before you can create the first project version. The figure, Versions in SAP Project Management, shows how you can edit versions. To manage a version in SAP Project Management, choose Versions on the initial screen, then choose the type of the version, and choose Version Management. The system then displays the screen as shown in the figure. Separate versions are created for snapshots and simulations. In addition, a distinction is made between local versions and global versions. Any project administrator can use local versions. Only users with extensive authorizations can edit or, in particular, create global versions. You can use versions for project versions only when they are released and when the current date is inside the validity area of the version. In Customizing, you define input templates for permitted version numbers. Project Version Configuration You need to make two settings in Customizing for PPM to configure versions. One setting affects the project type and the other affects a profile for defining the version numbers. In the project type, the Versions checkbox must be selected. This checkbox determines if you are able to create versions for projects of the current project type. Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 216
225.
7/26/2020 SAP e-book 1/1 The
checkbox affects snapshots and simulations in the same way. The profile Define Permitted Version Numbers defines permitted version numbers and their properties. The figure, Configuration of Versions in SAP Project Management, shows the path in Customizing for SAP Project Management and the affected profile. In the example, the version number VER* is defined. This means that versions can start with the characters VER. The placeholder * can be any character string. A valid name can be VER007b. The placeholder + can be used for a single random character. The version number and its properties are defined in the same profile. You can specify the following indicators when configuring versions: ● Version Number determines whether the version number can be used for snapshots or simulations. A version number can only be used for one type of version at a time. ● Usage has the attributes local and global. A project administrator can create local versions and use them for evaluations. For global versions, you need the authorization object CPRO_VSHDR. ● Archiving ensures that when a project is archived, the respective project versions are also archived. ● Extraction to BW determines if the project version can be extracted to SAP Business Intelligence. Snapshot Versions A snapshot is a representation of an operational project. You can use this representation to display the project status later on and to reconcile it with the project status of the operational project. You cannot change snapshots. Figure 121: Snapshot in SAP Project Management Snapshots can be created in the following ways: ● You can create them manually when you are editing an operational project. ● You can create them manually by copying an operational project using the Project Versions menu. ● The system can create them automatically during background processing. Lesson: Project Versions © Copyright. All rights reserved. 217
226.

7/26/2020 SAP e-book 1/1 In

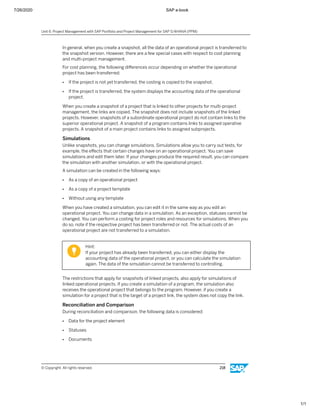

general, when you create a snapshot, all the data of an operational project is transferred to the snapshot version. However, there are a few special cases with respect to cost planning and multi-project management. For cost planning, the following differences occur depending on whether the operational project has been transferred: ● If the project is not yet transferred, the costing is copied to the snapshot. ● If the project is transferred, the system displays the accounting data of the operational project. When you create a snapshot of a project that is linked to other projects for multi-project management, the links are copied. The snapshot does not include snapshots of the linked projects. However, snapshots of a subordinate operational project do not contain links to the superior operational project. A snapshot of a program contains links to assigned operative projects. A snapshot of a main project contains links to assigned subprojects. Simulations Unlike snapshots, you can change simulations. Simulations allow you to carry out tests, for example, the effects that certain changes have on an operational project. You can save simulations and edit them later. If your changes produce the required result, you can compare the simulation with another simulation, or with the operational project. A simulation can be created in the following ways: ● As a copy of an operational project ● As a copy of a project template ● Without using any template When you have created a simulation, you can edit it in the same way as you edit an operational project. You can change data in a simulation. As an exception, statuses cannot be changed. You can perform a costing for project roles and resources for simulations. When you do so, note if the respective project has been transferred or not. The actual costs of an operational project are not transferred to a simulation. Hint: If your project has already been transferred, you can either display the accounting data of the operational project, or you can calculate the simulation again. The data of the simulation cannot be transferred to controlling. The restrictions that apply for snapshots of linked projects, also apply for simulations of linked operational projects. If you create a simulation of a program, the simulation also receives the operational project that belongs to the program. However, if you create a simulation for a project that is the target of a project link, the system does not copy the link. Reconciliation and Comparison During reconciliation and comparison, the following data is considered: ● Data for the project element ● Statuses ● Documents Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 218
227.

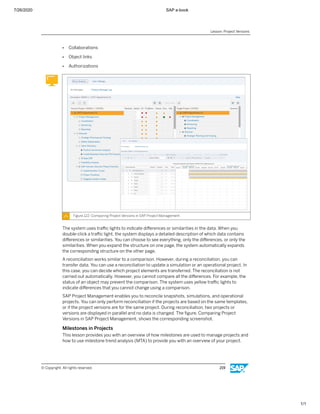

7/26/2020 SAP e-book 1/1 ●
Collaborations ● Object links ● Authorizations Figure 122: Comparing Project Versions in SAP Project Management The system uses traffic lights to indicate differences or similarities in the data. When you double-click a traffic light, the system displays a detailed description of which data contains differences or similarities. You can choose to see everything, only the differences, or only the similarities. When you expand the structure on one page, the system automatically expands the corresponding structure on the other page. A reconciliation works similar to a comparison. However, during a reconciliation, you can transfer data. You can use a reconciliation to update a simulation or an operational project. In this case, you can decide which project elements are transferred. The reconciliation is not carried out automatically. However, you cannot compare all the differences. For example, the status of an object may prevent the comparison. The system uses yellow traffic lights to indicate differences that you cannot change using a comparison. SAP Project Management enables you to reconcile snapshots, simulations, and operational projects. You can only perform reconciliation if the projects are based on the same templates, or if the project versions are for the same project. During reconciliation, two projects or versions are displayed in parallel and no data is changed. The figure, Comparing Project Versions in SAP Project Management, shows the corresponding screenshot. Milestones in Projects This lesson provides you with an overview of how milestones are used to manage projects and how to use milestone trend analysis (MTA) to provide you with an overview of your project. Lesson: Project Versions © Copyright. All rights reserved. 219
228.
7/26/2020 SAP e-book 1/1 Milestones

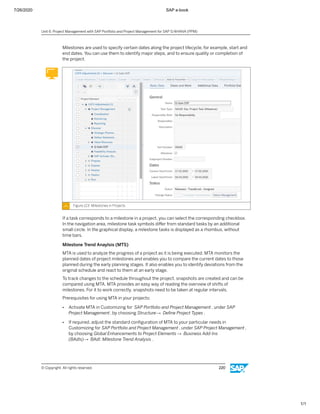

are used to specify certain dates along the project lifecycle, for example, start and end dates. You can use them to identify major steps, and to ensure quality or completion of the project. Figure 123: Milestones in Projects If a task corresponds to a milestone in a project, you can select the corresponding checkbox. In the navigation area, milestone task symbols differ from standard tasks by an additional small circle. In the graphical display, a milestone tasks is displayed as a rhombus, without time bars. Milestone Trend Anaylsis (MTS) MTA is used to analyze the progress of a project as it is being executed. MTA monitors the planned dates of project milestones and enables you to compare the current dates to those planned during the early planning stages. It also enables you to identify deviations from the original schedule and react to them at an early stage. To track changes to the schedule throughout the project, snapshots are created and can be compared using MTA. MTA provides an easy way of reading the overview of shifts of milestones. For it to work correctly, snapshots need to be taken at regular intervals. Prerequisites for using MTA in your projects: ● Activate MTA in Customizing for SAP Portfolio and Project Management , under SAP Project Management, by choosing Structure→ Define Project Types . ● If required, adjust the standard configuration of MTA to your particular needs in Customizing for SAP Portfolio and Project Management , under SAP Project Management, by choosing Global Enhancements to Project Elements → Business Add-Ins (BAdIs)→ BAdI: MIlestone Trend Analysis . Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 220
229.
7/26/2020 SAP e-book 1/1 ●
To print the MTA as a PDF, ensure Adobe Reader, or the corresponding plug-in is installed and that you have created and activated the required forms in Customizing for SAP Portfolio and Project Management , under SAP Project Management, by choosing Basic Settings→ Forms for Printing and for Project Status Reports . MTA is based on the following project data: ● All project tasks that have been flagged as milestones. ● All snapshot versions that have been created for the project. MTA only provides useful information if the project participants responsible for individual milestones regularly update the planned dates of the milestone tasks, and if these updates are documented in snapshots. For each milestone task of a project, the MTA displays the planned finish dates saved in the individual snapshots as well as current project data. On the General tab page of your user settings, you can specify whether you see the earliest or latest dates. Note: On the General tab page of your user settings, you can also specify whether you see the earliest or latest dates for other functions, such as the Gantt chart of your project. MTA can be represented as an MTA chart or a table, using the SAP List Viewer (ALV). In the MTA chart, the milestone dates, which are indicated on the vertical axis, are plotted against the snapshot creation dates, are indicated on the horizontal axis. The milestone date from the current project is plotted against the current date. Each milestone is represented in the chart by a line on which the snapshots are indicated by dots. The tooltips of these dots provide information on the name and date of the milestone and the snapshot. The ALV table contains a line for each milestone with information on the type and status of the milestone task and the corresponding phase. For each snapshot, an extra column is displayed that shows the planned finished dates of the milestones with the snapshot creation date added in the bottom line. The last column displays the current milestone data and the current date. The following functions support you when analyzing MTA data: ● Accessing milestone data in a snapshot or project. You do this by double-clicking on the corresponding cell in the ALV table. You ban navigate to the Dates and Work tab page of a milestone task within a snapshot or project. ● Sorting and filtering the milestone tasks. You can use the standard ALV settings and functions to sort and filter the columns of the ALV table. The MTA chart and the ALV table always display the same data. Any filter applied to the ALV table is also reflected in the MTA chart. ● Exporting MTA data. You can use the standard ALV functionality to export MTA data contained in the ALV table to Microsoft Excel. ● Printing MTA. You can print the MTA chart as a graphic by choosing Print→ As Graphic. The graphic is displayed in the browser and can be saved or printed using standard browser functionality. Lesson: Project Versions © Copyright. All rights reserved. 221
230.
7/26/2020 SAP e-book 1/1 Alternatively,

you can print the MTA as a PDF by choosing, Print→ As PDF. The content and layout of the document are determined by the PDF form used. Depending on your Customizing settings, this form is chosen automatically, or you can select it in a dialog box. The document is displayed and can be printed in Adobe Reader. LESSON SUMMARY You should now be able to: ● Project snapshots and simulation versions Unit 6: Project Management with SAP Portfolio and Project Management for SAP S/4HANA (PPM) © Copyright. All rights reserved. 222
231.
7/26/2020 SAP e-book 1/1 Unit

6 Learning Assessment 1. Which of the following are prerequisites for successful projects? Choose the correct answers. X A Specifications must be precise and you should have a written copy of them. X B Different roles and activities in the project must be defined. X C Specifications must be broad and should evolve as the projects progress. X D Focus on planning and avoiding errors in the early phases. 2. Some of the central functions of SAP Project Management can be used as standalone solutions. Determine whether this statement is true or false. X True X False 3. Which project element contains general information on the project? Choose the correct answer. X A Project definition X B Phase X C Task X D Project role © Copyright. All rights reserved. 223
232.
7/26/2020 SAP e-book 1/1 4.
Which of the following statements best explains the character of phases in SAP Project Management. Choose the correct answer. X A Phases are used for structuring a project from the cost aspect. X B Phases are used for structuring a project from the time aspect. X C Phases are used to structure the required processing steps when a project is being implemented. X D A phase lists the item in a project that must be completed. 5. You can assign several checklists to a phase. Determine whether this statement is true or false. X True X False 6. Which of the following elements can be assigned to a task? Choose the correct answers. X A Phases X B Checklists X C Checklist items X D Subtasks 7. Which settings are maintained in the project type? Choose the correct answers. X A Accounting integration X B Confirmation settings X C Approval process X D Cost rate 8. You can manage your documents in SAP Project Management with the SAP Project Management document function or with SAP DMS. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 224
233.
7/26/2020 SAP e-book 1/1 9.
Which authorization types are available in SAP Project Management? Choose the correct answers. X A Project-specific authorizations X B Portfolio-specific authorizations X C General authorizations X D Basic authorizations 10. Authorizations that you grant at the project definition level are not automatically passed on to all subordinate objects in the project. Determine whether this statement is true or false. X True X False 11. Which authorizations can only be assigned for the project definition? Choose the correct answers. X A Read X B Write X C Evaluate X D Accounting X E Administration 12. Which of the following scheduling types determines the duration of the phases from scheduling subordinate tasks and their relationship? Choose the correct answer. X A Top-down scheduling X B Bottom-up scheduling Unit 6: Learning Assessment © Copyright. All rights reserved. 225
234.
7/26/2020 SAP e-book 1/1 13.
Which date types can you maintain for each individual project element? Choose the correct answers. X A Planned dates X B Overlapping dates X C Constraints X D Forecasted dates X E Extrapolated dates 14. Relationships are only linked between tasks at the same level of the hierarchy. Determine whether this statement is true or false. X True X False 15. Which of the following represents general descriptions of the resource requirements? Choose the correct answer. X A Qualifications X B Tasks X C Role types X D Roles 16. Resource planning in Project Management assigns employees directly to tasks of a project. Determine whether this statement is true or false. X True X False 17. When you create roles for a project, you can only access the role types that are assigned to the project type. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 226
235.
7/26/2020 SAP e-book 1/1 18.
A project role describes the type of resource that is required in a project. Determine whether this statement is true or false. X True X False 19. What can you use to specify the demand of a project role in SAP Project Management. Choose the correct answers. X A Distributed demand X B Total demand X C Altered demand X D Spread demand 20. You can assign subtasks to project roles. Determine whether this statement is true or false. X True X False 21. You cannot integrate resource planning data from Project Management with SAP Portfolio and Project Management (PPM) capacity planning. Determine whether this statement is true or false. X True X False 22. What are resources that you can use for the staffing of roles in Project Management projects called? Choose the correct answer. X A Members X B Employees X C Staff X D Business partners Unit 6: Learning Assessment © Copyright. All rights reserved. 227
236.
7/26/2020 SAP e-book 1/1 23.
You can create business partners using HCM integration with the existing HR data of employees. Determine whether this statement is true or false. X True X False 24. Which business partner roles are used in SAP Project Management? Choose the correct answer. X A Employee X B Resource X C Contractor X D Vendor 25. Which criteria can be used to add business partners/ resources to a resource pool? Choose the correct answers. X A Location X B Name X C Qualification X D Availability 26. Which traffic light signals a project role is overstaffed? Choose the correct answer. X A Red X B Yellow X C Green 27. The project lead determines which organizational units should be responsible for resource search and candidate management. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 228
237.
7/26/2020 SAP e-book 1/1 28.
In SAP Project Management a tool is available to check and resolve scheduling conflicts on one screen. Determine whether this statement is true or false. X True X False 29. Which controlling methods are based on accounting integration to SAP Project System (PS)? Choose the correct answers. X A Internal order (structure element, manual) X B Internal order (project role, manual) X C Multilevel controlling (structure element, manual) X D Multilevel controlling (project role, automatic) 30.If you use multilevel controlling, what is the status of the WBS elements that were created automatically during a transfer? Choose the correct answer. X A Master data locked X B Flag to transfer X C Release X D Lock 31. Which Customizing activity do you choose to define the corresponding SAP system for accounting integration? Choose the correct answer. X A Activate Accounting Integration in Project Type X B Active Object Links for Accounting Integration X C Specify General Settings X D Make Settings in SAP S/4 Unit 6: Learning Assessment © Copyright. All rights reserved. 229
238.
7/26/2020 SAP e-book 1/1 32.
The execution of projects in Project Management starts with the release of the project definition. Determine whether this statement is true or false. X True X False 33. What happens when the project definition of a project is released? Choose the correct answer. X A The first phase of a project is released. X B The first two phases of the project are released. X C All the phases of a project are released. X D None of the phases of a project are released. 34. You can only enter confirmations if the task or the checklist item has the status Released or In Process. Determine whether this statement is true or false. X True X False 35. Which status indicates that the task is terminated? Choose the correct answer. X A Canceled X B Closed X C Completed X D Released 36. Accounting integration must not be active for a project to enter time using Cross- Application Times Sheet (CATS). Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 230
239.
7/26/2020 SAP e-book 1/1 37.
In confirmations for checklist items you can specify the work, the remaining work, or the percentage of completion. Determine whether this statement is true or false. X True X False 38. After the completion of a phase, you can make minor changes to master data of the phase. Determine whether this statement is true or false. X True X False 39. Who can grant or reject the approval for a phase? Choose the correct answer. X A Decision makers X B Project managers X C All project participants X D No one needs to approve a phase 40.Which layout specifies the columns of a standard report, such as "Completed Checklist Items"? Choose the correct answer. X A Extract layout X B Evaluation layout 41. You can assign several templates to the same project type and choose between different templates. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 231
240.

7/26/2020 SAP e-book 1/1 42.

Threshold value violations for project elements can only be triggered manually. Determine whether this statement is true or false. X True X False 43. Which of the following Customizing settings are required to enable the automatic determination of threshold value violations? Choose the correct answers. X A Assign Extract Layouts to Object Types X B Define Evaluations X C Define Severity X D Define Threshold Values 44. Threshold value violations are checked when you save a project. Determine whether this statement is true or false. X True X False 45. Only users with extensive authorizations can create or edit global versions. Determine whether this statement is true or false. X True X False 46. Which options are available to create snapshots? Choose the correct answers. X A Manually when you are editing an operational project X B Copy a snapshot X C Manually by copying an operational project X D Copy a template Unit 6: Learning Assessment © Copyright. All rights reserved. 232
241.
7/26/2020 SAP e-book 1/1 47.
You can use a comparison to update a simulation or an operational project. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment © Copyright. All rights reserved. 233
242.
7/26/2020 SAP e-book 1/1 Unit
6 Learning Assessment - Answers 1. Which of the following are prerequisites for successful projects? Choose the correct answers. X A Specifications must be precise and you should have a written copy of them. X B Different roles and activities in the project must be defined. X C Specifications must be broad and should evolve as the projects progress. X D Focus on planning and avoiding errors in the early phases. 2. Some of the central functions of SAP Project Management can be used as standalone solutions. Determine whether this statement is true or false. X True X False 3. Which project element contains general information on the project? Choose the correct answer. X A Project definition X B Phase X C Task X D Project role © Copyright. All rights reserved. 234
243.
7/26/2020 SAP e-book 1/1 4.
Which of the following statements best explains the character of phases in SAP Project Management. Choose the correct answer. X A Phases are used for structuring a project from the cost aspect. X B Phases are used for structuring a project from the time aspect. X C Phases are used to structure the required processing steps when a project is being implemented. X D A phase lists the item in a project that must be completed. 5. You can assign several checklists to a phase. Determine whether this statement is true or false. X True X False 6. Which of the following elements can be assigned to a task? Choose the correct answers. X A Phases X B Checklists X C Checklist items X D Subtasks 7. Which settings are maintained in the project type? Choose the correct answers. X A Accounting integration X B Confirmation settings X C Approval process X D Cost rate Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 235
244.
7/26/2020 SAP e-book 1/1 8.
You can manage your documents in SAP Project Management with the SAP Project Management document function or with SAP DMS. Determine whether this statement is true or false. X True X False 9. Which authorization types are available in SAP Project Management? Choose the correct answers. X A Project-specific authorizations X B Portfolio-specific authorizations X C General authorizations X D Basic authorizations 10. Authorizations that you grant at the project definition level are not automatically passed on to all subordinate objects in the project. Determine whether this statement is true or false. X True X False Correct. Authorizations that you grant at the project definition level are automatically passed on to all subordinate objects in the project, but you can adjust, enhance, or even revoke them there if necessary. 11. Which authorizations can only be assigned for the project definition? Choose the correct answers. X A Read X B Write X C Evaluate X D Accounting X E Administration Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 236
245.
7/26/2020 SAP e-book 1/1 12.
Which of the following scheduling types determines the duration of the phases from scheduling subordinate tasks and their relationship? Choose the correct answer. X A Top-down scheduling X B Bottom-up scheduling Correct. With bottom-up scheduling, the duration of the phases is determined by scheduling subordinate tasks and their relationship. 13. Which date types can you maintain for each individual project element? Choose the correct answers. X A Planned dates X B Overlapping dates X C Constraints X D Forecasted dates X E Extrapolated dates 14. Relationships are only linked between tasks at the same level of the hierarchy. Determine whether this statement is true or false. X True X False 15. Which of the following represents general descriptions of the resource requirements? Choose the correct answer. X A Qualifications X B Tasks X C Role types X D Roles Correct. Roles represent general descriptions of the resource requirements. Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 237
246.
7/26/2020 SAP e-book 1/1 16.
Resource planning in Project Management assigns employees directly to tasks of a project. Determine whether this statement is true or false. X True X False 17. When you create roles for a project, you can only access the role types that are assigned to the project type. Determine whether this statement is true or false. X True X False Correct. When you create roles for a project, you can only access the role types that are assigned to the project type. 18. A project role describes the type of resource that is required in a project. Determine whether this statement is true or false. X True X False 19. What can you use to specify the demand of a project role in SAP Project Management. Choose the correct answers. X A Distributed demand X B Total demand X C Altered demand X D Spread demand 20. You can assign subtasks to project roles. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 238
247.
7/26/2020 SAP e-book 1/1 21.
You cannot integrate resource planning data from Project Management with SAP Portfolio and Project Management (PPM) capacity planning. Determine whether this statement is true or false. X True X False Correct. You can integrate resource planning data from Project Management with PPM capacity planning. 22. What are resources that you can use for the staffing of roles in Project Management projects called? Choose the correct answer. X A Members X B Employees X C Staff X D Business partners Correct. Business partners are the resources that you can use for the staffing of roles in Project Management projects. 23. You can create business partners using HCM integration with the existing HR data of employees. Determine whether this statement is true or false. X True X False Correct. You can create business partners using HCM integration with the existing HR data of employees. 24. Which business partner roles are used in SAP Project Management? Choose the correct answer. X A Employee X B Resource X C Contractor X D Vendor Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 239

248.
7/26/2020 SAP e-book 1/1 25.
Which criteria can be used to add business partners/ resources to a resource pool? Choose the correct answers. X A Location X B Name X C Qualification X D Availability 26. Which traffic light signals a project role is overstaffed? Choose the correct answer. X A Red X B Yellow X C Green Correct. A red traffic light signals a project role is overstaffed. 27. The project lead determines which organizational units should be responsible for resource search and candidate management. Determine whether this statement is true or false. X True X False Correct. The project lead determines which organizational units should be responsible for resource search and candidate management. 28. In SAP Project Management a tool is available to check and resolve scheduling conflicts on one screen. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 240
249.
7/26/2020 SAP e-book 1/1 29.
Which controlling methods are based on accounting integration to SAP Project System (PS)? Choose the correct answers. X A Internal order (structure element, manual) X B Internal order (project role, manual) X C Multilevel controlling (structure element, manual) X D Multilevel controlling (project role, automatic) 30.If you use multilevel controlling, what is the status of the WBS elements that were created automatically during a transfer? Choose the correct answer. X A Master data locked X B Flag to transfer X C Release X D Lock 31. Which Customizing activity do you choose to define the corresponding SAP system for accounting integration? Choose the correct answer. X A Activate Accounting Integration in Project Type X B Active Object Links for Accounting Integration X C Specify General Settings X D Make Settings in SAP S/4 32. The execution of projects in Project Management starts with the release of the project definition. Determine whether this statement is true or false. X True X False Correct. The execution of projects in Project Management starts with the release of the project definition. Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 241
250.
7/26/2020 SAP e-book 1/1 33.
What happens when the project definition of a project is released? Choose the correct answer. X A The first phase of a project is released. X B The first two phases of the project are released. X C All the phases of a project are released. X D None of the phases of a project are released. 34. You can only enter confirmations if the task or the checklist item has the status Released or In Process. Determine whether this statement is true or false. X True X False 35. Which status indicates that the task is terminated? Choose the correct answer. X A Canceled X B Closed X C Completed X D Released 36. Accounting integration must not be active for a project to enter time using Cross- Application Times Sheet (CATS). Determine whether this statement is true or false. X True X False 37. In confirmations for checklist items you can specify the work, the remaining work, or the percentage of completion. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 242
251.
7/26/2020 SAP e-book 1/1 38.
After the completion of a phase, you can make minor changes to master data of the phase. Determine whether this statement is true or false. X True X False 39. Who can grant or reject the approval for a phase? Choose the correct answer. X A Decision makers X B Project managers X C All project participants X D No one needs to approve a phase 40.Which layout specifies the columns of a standard report, such as "Completed Checklist Items"? Choose the correct answer. X A Extract layout X B Evaluation layout 41. You can assign several templates to the same project type and choose between different templates. Determine whether this statement is true or false. X True X False 42. Threshold value violations for project elements can only be triggered manually. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 243
252.
7/26/2020 SAP e-book 1/1 43.
Which of the following Customizing settings are required to enable the automatic determination of threshold value violations? Choose the correct answers. X A Assign Extract Layouts to Object Types X B Define Evaluations X C Define Severity X D Define Threshold Values 44. Threshold value violations are checked when you save a project. Determine whether this statement is true or false. X True X False 45. Only users with extensive authorizations can create or edit global versions. Determine whether this statement is true or false. X True X False 46. Which options are available to create snapshots? Choose the correct answers. X A Manually when you are editing an operational project X B Copy a snapshot X C Manually by copying an operational project X D Copy a template 47. You can use a comparison to update a simulation or an operational project. Determine whether this statement is true or false. X True X False Unit 6: Learning Assessment - Answers © Copyright. All rights reserved. 244
253.
7/26/2020 SAP e-book 1/1 UNIT
7 Portfolio Items and Project Management Projects Lesson 1 Linking Portfolio Items and Project Management Projects 246 Lesson 2 Integrating Resource and Capacity Planning 250 UNIT OBJECTIVES ● Link projects and portfolio items ● Outline the configuration of links for projects and portfolio items ● Enable integration for capacity views ● Check the integration of capacity views © Copyright. All rights reserved. 245
254.
7/26/2020 SAP e-book 1/1 Unit
7 Lesson 1 Linking Portfolio Items and Project Management Projects LESSON OVERVIEW This lesson shows how to manually or automatically link portfolio items in SAP Portfolio and Project Management with projects from Project Management. Business Example After you have implemented a preliminary plan at the portfolio item level and entered critical success factors, you use the Project Management functions for a detailed plan of your project. To exchange data and to simplify navigation between Portfolio Management and Project Management, you want to link Project Management projects with your portfolio items. For this reason, you require the following knowledge: ● An understanding of how to manually link portfolio items with Project Management projects ● An understanding of how to create Project Management projects from portfolio items ● An understanding of how to make the relevant settings in Customizing for SAP Portfolio and Project Management LESSON OBJECTIVES After completing this lesson, you will be able to: ● Link projects and portfolio items ● Outline the configuration of links for projects and portfolio items © Copyright. All rights reserved. 246
255.
7/26/2020 SAP e-book 1/1 Portfolio
Item and Project Management Project Figure 124: Possible Link Options There are various options for linking projects from Project Management with portfolio items. First, you can separately create a portfolio item and a Project Management project, then link them later. You can establish this subsequent link from the portfolio item by using the Related Objects tab. This enables you to search for existing Project Management projects and assign these to the portfolio item. After the assignment, some general information about the Project Management project, such as the description or project type, is displayed. You can also cancel an existing assignment if you want to create an assignment to another Project Management project. However, only one Project Management project can ever be assigned to a portfolio item at one time. Hint: The Related Objects tab also lets you establish links to initiatives or PS projects. Once a link is established, you can also link phases of assigned Project Management projects with decision points of the portfolio item. Second, you can create a portfolio item and a Project Management project, either at the time of creation or at a later time from the portfolio item using a template, and make the link to both objects at the same time. If you want the Project Management project to be created at the same time as the portfolio item, set the indicator Create Project on Saving before you save. You can specify the Project Management template that you want to use as a copy template. If you want the Project Management project to be created and linked at a later stage, do not set the indicator Create Project on Saving when you save the portfolio item. You can set the indicator Create Project on Saving later to create and assign a Project Management project. Depending on synchronization settings, the planned start and end date of the portfolio item is transferred to the definition of the Project Management project. Because templates in Project Management always contain a reference to a project type, you must assign a project type to the item type of the portfolio item in Customizing. Lesson: Linking Portfolio Items and Project Management Projects © Copyright. All rights reserved. 247
256.
7/26/2020 SAP e-book 1/1 Both
the options (discussed so far) for creating and linking Project Management projects are useful if Project Management is the leading system for the operational project management. Other objects, such as internal orders from FI/CO or work breakdown structures from Project System, are useful only for Controlling purposes in the relevant Project Management projects. However, if another project management application, such as Microsoft Project or Project System, is used for operational project management, a Project Management project linked with a portfolio item serves only to evaluate data of the external project management application. In these scenarios, a project definition is created in Project Management when a portfolio item is created, because this is a prerequisite for uploading structure and resource data of external project management applications. The structure of the Project Management project and the corresponding roles are created later when you upload project data from an external project management application. Configuration of Links Figure 125: Customizing for Link Options To use link option 1 – the separate creation of a portfolio item and Project Management project and the subsequent assignment of both objects – no Customizing settings are necessary. However, to ensure that a Project Management project is not automatically created when you save the portfolio item, you can deselect the Automatically create a Project checkbox in the definition of the portfolio item type in Customizing for SAP Portfolio and Project Management (PPM). To use link option 2 – the creation of a Project Management project with a template from a portfolio item – you must assign a project type to the portfolio item type in Customizing for PPM. The project type determines which templates are available for the creation of the Project Management project. If required, you can also make direct assignments between portfolio item types and Project Management templates. You can do this in the Customizing activity Map Item Type to Project or PS . Unit 7: Portfolio Items and Project Management Projects © Copyright. All rights reserved. 248
257.
7/26/2020 SAP e-book 1/1 Hint: The
creation of an item with an item template is a special case. Depending on the configuration, a Project Management project is immediately created with a template in this case. In doing so, links between the phases of the project and the decision points of the item can be created immediately. To use link option 3 – the creation of a project definition when a portfolio item type is saved – you must select the Create Project on Saving checkbox when you save the portfolio item. The following strategies are used to determine the project type that is used for the creation of the Project Management project: ● Project type that is assigned to the portfolio item type ● Project type that you defined in the global settings in Customizing for PPM in the area 0009 Portfolio Item Project Integration ● Project type that is defined as an SAP default setting in the global settings LESSON SUMMARY You should now be able to: ● Link projects and portfolio items ● Outline the configuration of links for projects and portfolio items Lesson: Linking Portfolio Items and Project Management Projects © Copyright. All rights reserved. 249
258.
7/26/2020 SAP e-book 1/1 Unit
7 Lesson 2 Integrating Resource and Capacity Planning LESSON OVERVIEW This lesson shows how the detailed information of resource planning can be integrated into strategic capacity planning in SAP Portfolio and Project Management. Business Example You have performed an initial estimate of the resource requirements at the portfolio bucket and item level in strategic capacity planning in SAP Portfolio and Project Management. After a detailed resource planning, you want to compare this detailed data with your estimates. For this reason, you require the following knowledge: ● An understanding of the options for integrating data into SAP Portfolio and Project Management capacity planning ● An understanding of how to make the Customizing settings required for integration LESSON OBJECTIVES After completing this lesson, you will be able to: ● Enable integration for capacity views ● Check the integration of capacity views © Copyright. All rights reserved. 250
259.
7/26/2020 SAP e-book 1/1 Capacity

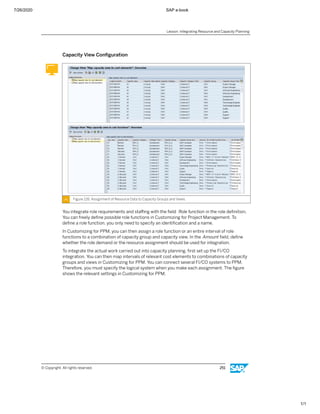

View Configuration Figure 126: Assignment of Resource Data to Capacity Groups and Views You integrate role requirements and staffing with the field Role function in the role definition. You can freely define possible role functions in Customizing for Project Management. To define a role function, you only need to specify an identification and a name. In Customizing for PPM, you can then assign a role function or an entire interval of role functions to a combination of capacity group and capacity view. In the Amount field, define whether the role demand or the resource assignment should be used for integration. To integrate the actual work carried out into capacity planning, first set up the FI/CO integration. You can then map intervals of relevant cost elements to combinations of capacity groups and views in Customizing for PPM. You can connect several FI/CO systems to PPM. Therefore, you must specify the logical system when you make each assignment. The figure shows the relevant settings in Customizing for PPM. Lesson: Integrating Resource and Capacity Planning © Copyright. All rights reserved. 251
260.
7/26/2020 SAP e-book 1/1 Integration
of Resource Planning and Capacity Planning Figure 127: Example of Integration with Resource Planning Data Using PPM capacity planning, you can plan requirements for capacities or resources for individual periods at the portfolio bucket level, item level, and initiative level. This planning refers to capacity categories, groups, and views, which you can freely define in Customizing for PPM. Values that you have planned at the portfolio item level can be rolled up to parent portfolio buckets or initiatives with the relevant Customizing settings. You can manually perform capacity planning at the portfolio item level or derive it from role demands or resource assignments of Project Management projects. Possible Integration Scenarios Figure 128: Possible Integration Scenarios Unit 7: Portfolio Items and Project Management Projects © Copyright. All rights reserved. 252
261.
7/26/2020 SAP e-book 1/1 Resource
data can be integrated in two ways. The role demand and resource assignments can be mapped to combinations of capacity groups and views. You can do this using a role function that you can assign to a role within the role definition. You can manually define roles and the staffing of these roles in Project Management, or derive them from other assigned project management applications. The other option is to determine actual capacity requirements from the confirmed activities. This requires integration with an FI/CO system in which activity values were entered using the Cross-Application Time Sheet (CATS). If resource data have been integrated into capacity planning, you can roll this data up to the parent portfolio buckets or initiatives. At the bucket and initiative level, you can perform aggregated evaluations and compare the data to your original forecast capacity planning data. You can roll the portfolio item data up to the parent buckets or initiatives using the program /RPM/FICO_INT_PLANNING with the execution option Rollup. LESSON SUMMARY You should now be able to: ● Enable integration for capacity views ● Check the integration of capacity views Lesson: Integrating Resource and Capacity Planning © Copyright. All rights reserved. 253
262.

7/26/2020 SAP e-book 1/1 Unit
7 Learning Assessment 1. Only one Project Management project can be assigned to a portfolio item at one time. Determine whether this statement is true or false. X True X False 2. To integrate the actual work carried out into capacity planning, you must first set up the FI/CO integration. Determine whether this statement is true or false. X True X False 3. You can perform capacity planning at the portfolio item level manually. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 254
263.
7/26/2020 SAP e-book 1/1 Unit
7 Learning Assessment - Answers 1. Only one Project Management project can be assigned to a portfolio item at one time. Determine whether this statement is true or false. X True X False Correct. Only one Project Management project can be assigned to a portfolio item at one time. 2. To integrate the actual work carried out into capacity planning, you must first set up the FI/CO integration. Determine whether this statement is true or false. X True X False Correct. To integrate the actual work carried out into capacity planning, you must first set up the FI/CO integration. 3. You can perform capacity planning at the portfolio item level manually. Determine whether this statement is true or false. X True X False Correct. You can perform capacity planning at the portfolio item level manually. © Copyright. All rights reserved. 255
264.
7/26/2020 SAP e-book 1/1 UNIT
8 SAP Portfolio Management and SAP Applications Integration Lesson 1 Integrating Project System (PS) 257 Lesson 2 Configuring the Project System (PS) Integration 262 Lesson 3 Configuring the SAP Financials Integration 264 Lesson 4 Integrating SAP Portfolio Management with SAP ERP Financial Data 267 Lesson 5 Integrating SAP Innovation Management 273 UNIT OBJECTIVES ● Outline the integration of PS ● Create a PS project in SAP PPM ● Check the synchronization of attributes and statuses ● Outline the integration of financial data of PS projects ● Check the configuration of the PS integration ● Configure the integration of SAP Financials data to SAP PPM ● Integrate financial data from Project System (PS) ● Integrate financial data from PS projects ● Explain integration to SAP Innovation Management © Copyright. All rights reserved. 256
265.
7/26/2020 SAP e-book 1/1 Unit
8 Lesson 1 Integrating Project System (PS) LESSON OVERVIEW This lesson provides an overview of the integration of Project System (PS) to SAP Portfolio and Project Management (SAP PPM). Business Example Your company manages about a hundred projects per year. A year ago, your company implemented SAP Portfolio and Project Management to administer and analyze the project portfolio. Now, you are asked to establish a close integration between PS projects and portfolio items. For this reason, you require the following knowledge: ● An understanding of the concept of PS integration ● An understanding of PS project creation and PS project assignment ● An understanding of attribute synchronization and status synchronization ● An understanding of the integration of financial data of PS projects LESSON OBJECTIVES After completing this lesson, you will be able to: ● Outline the integration of PS ● Create a PS project in SAP PPM ● Check the synchronization of attributes and statuses ● Outline the integration of financial data of PS projects © Copyright. All rights reserved. 257
266.
7/26/2020 SAP e-book 1/1 PS
Integration Figure 129: Concept of SAP PS Integration Portfolio items are used to plan and schedule on a strategic scale. You can perform operative project management with respect to a portfolio item with Project Management integrated in SAP Portfolio and Project Management (PPM). As an alternative, you can perform operative project management with respect to a portfolio item with Project System (PS). If you have used PS for operative project management in the past, you can now easily link such projects to items to synchronize data. You can create and link PS projects to portfolio items. Once a link is established, you can synchronize attributes and status between both applications. The figure, Concept of SAP PS Integration, demonstrates what objects can be linked to each other. You can link a project definition to an item and you can link work breakdown structure (WBS) elements to decision points of an item. The link is established by object link types. In this way, you can synchronize attributes and status between PS projects, and item and decision points. PS Project Creation Figure 130: Creation of a PS Project Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 258
267.
7/26/2020 SAP e-book 1/1 You
can create PS projects directly in PPM. You can either manually create the PS project while saving the portfolio item, or you can automatically create the PS project. The latter, however, requires the implementation of a BAdI. The figure, Creation of a PS Project, demonstrates the creation of an item and the creation of a PS project while saving the item. Depending on the configuration settings, you can choose a template to create PS projects. A project definition and subordinate WBS elements are created. And again depending on the configuration, WBS elements are linked to item decision points. Hint: Network components, documents, and PS texts are not copied from the PS project template. Once you establish a link to the PS project, an additional button appears on the item detail screen. The button allows you to display the PS project with Project Builder and go to three PS reports to analyze the PS project. PS Project Assignment Figure 131: Assignment of a PS Project As an alternative to creating a new PS project, you can assign an existing PS project to an item. First, you create a link to a PS project definition. Later, you can assign WBS elements and decision points. The figure, Assignment of a PS Project, demonstrates the respective tab page and buttons to assign a PS project. The figure also displays a button to delete assignments. Lesson: Integrating Project System (PS) © Copyright. All rights reserved. 259
268.
7/26/2020 SAP e-book 1/1 Attribute
Synchronization Figure 132: Synchronization of Attributes Synchronization is a major benefit of integrating a PS project to an item. You can synchronize attributes and statuses. Some attributes of the item are mapped to attributes of the PS project definition. Vice versa, some attributes of the PS project are mapped to attributes of the item and decision points. Synchronization is based on Decision Flow Management (DFM), which is a common function of PPM. You must adjust the DFM configuration to your needs and you must specify field mapping. The SAP standard delivery already contains a minimal field mapping, which can be used as a starting point for attribute synchronization. Status Synchronization Portfolio items, decision points, PS projects, and WBS elements all contain status management. However, in PS, a status can allow or forbid a business transaction. The status of items and decision points is only for information purposes. With PS project integration to an item, you can synchronize the status between both objects. You can synchronize the status between WBS elements and decision points as well. Therefore, the status of an item can influence business transactions for a PS project. Conversely, the status of a PS project can provide feedback to the assigned item. Integration of Financial Data of PS Projects Financial data of PS projects assigned to portfolio items can be transferred to financial planning of the respective items. Financial integration allows you to transfer budgets, planned costs, and actual costs to portfolio item financial planning. In fact, FI/CO integration is based on object links similar to PS integration. However, different object link types are configured for FI/CO integration and for PS integration. Once you assign a PS project to an item, the system simultaneously creates an additional link for FI/CO integration automatically. Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 260
269.
7/26/2020 SAP e-book 1/1 LESSON
SUMMARY You should now be able to: ● Outline the integration of PS ● Create a PS project in SAP PPM ● Check the synchronization of attributes and statuses ● Outline the integration of financial data of PS projects Lesson: Integrating Project System (PS) © Copyright. All rights reserved. 261
270.
7/26/2020 SAP e-book 1/1 Unit
8 Lesson 2 Configuring the Project System (PS) Integration LESSON OVERVIEW This lesson provides an overview of configuring Project System (PS) integration. Business Example Your company manages about a hundred projects per year. Your company implemented SAP Portfolio and Project Management to administer and analyze the project portfolio. Now, you are asked to establish a close integration between PS projects and portfolio items. For this reason, you require the following knowledge: ● An understanding of how to configure the PS integration LESSON OBJECTIVES After completing this lesson, you will be able to: ● Check the configuration of the PS integration PS Integration Configuration Figure 133: Configuration of PS Integration The configuration of the PS integration requires a number of Customizing activities. © Copyright. All rights reserved. 262
271.

7/26/2020 SAP e-book 1/1 Steps

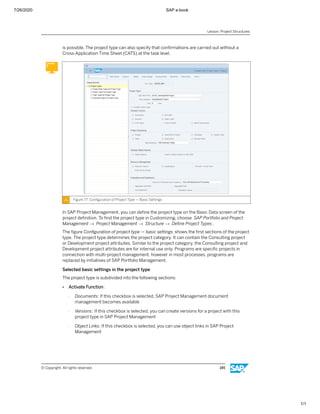

of Global Customizing of Portfolio Management 1. Specify item types for PS integration. Item types are specified for PS integration of Project Management (as a part of PPM). 2. Assign PS templates to project profiles, item templates, or item types. 3. Link decision points of item types or item templates to WBS elements. In addition, you must configure common functions of PPM. In particular, you have to maintain object link types of decision flow management. Suitable object link types for PS project definition and WBS elements are predefined in SAP Customizing. You can copy and adjust both object link types. That is, you assign the correct destination, web server alias, and logical system to the object link type. The settings described above are the minimal settings for using PS integration. However, you can adjust synchronization to your needs. You may introduce different synchronization scenarios for creating, updating, and deleting objects. LESSON SUMMARY You should now be able to: ● Check the configuration of the PS integration Lesson: Configuring the Project System (PS) Integration © Copyright. All rights reserved. 263
272.
7/26/2020 SAP e-book 1/1 Unit
8 Lesson 3 Configuring the SAP Financials Integration LESSON OVERVIEW This lesson shows how to configure the integration of SAP Financials data. Business Example In SAP Portfolio and Project Management, you have already performed strategic financial planning at the item level and bucket level. You now want to compare forecast data with detailed plan data, commitment data, actual data, and budget data from the FI/CO system to monitor your projects. For this reason, you require the following knowledge: ● An understanding of how to configure the SAP Financials data integration LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure the integration of SAP Financials data to SAP PPM SAP Financials Integration Figure 134: Customizing of the FI/CO Integration The figure, Customizing of the FI/CO Integration, summarizes the various Customizing activities that are relevant for the FI/CO integration. These Customizing activities can be roughly divided into the configuration for object link types and the definition of the mapping between cost elements and CO versions on the one hand, and financial groups and financial views on the other hand. Object link types are already defined in the standard SAP system for the integration of accounting data from internal orders and projects of Project System (PS). You can use these object link types as templates for creating new object link types in the customer-defined © Copyright. All rights reserved. 264
273.
7/26/2020 SAP e-book 1/1 namespace.
Specify the RFC connection and the logical system of the FI/CO system in your object link types. If you want to upload data from different FI/CO systems to PPM, you must create object link types for each system. Finally, activate the object link types that you want to use for the integration. The object link types that are used for the FI/CO integration are assigned to the SAP Controlling application. Settings for Financial Planning Figure 135: Settings for Financial Planning In PPM, financial data with reference to financial categories, groups, and financial views can be entered and evaluated in the financial planning. However, accounting data with reference to cost elements, value types, and CO versions is managed in the FI/CO system. Therefore, a mapping between the relevant reference data must be defined. You can perform the mapping according to your requirements in Customizing for PPM with reference to the relevant FI/CO system. The figure, Settings for Financial Planning, displays the table in Customizing in which you can make the relevant settings. The organizational unit that you specify in the settings corresponds to the controlling area in the FI/CO system. This is implemented by the assignment of the organizational unit type COA (controlling area) to the SAP Controlling application. Lesson: Configuring the SAP Financials Integration © Copyright. All rights reserved. 265
274.

7/26/2020 SAP e-book 1/1 Note: The
value types to be specified in the settings do not correspond to the value types in FI/CO, but are value types of SAP Portfolio and Project Management. By default, therefore, there are no separate value types in PPM for a purchase requisition commitment and a purchase order commitment, but only one value type commitment. LESSON SUMMARY You should now be able to: ● Configure the integration of SAP Financials data to SAP PPM Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 266
275.
7/26/2020 SAP e-book 1/1 Unit
8 Lesson 4 Integrating SAP Portfolio Management with SAP ERP Financial Data LESSON OVERVIEW This lesson covers the integration of accounting data in SAP Portfolio and Project Management. Business Example In SAP Portfolio and Project Management, you have already performed strategic financial planning at the item level and bucket level. You now want to compare forecast data with detailed plan data, commitment data, actual data, and budget data from the FI/CO system to monitor your projects. For this reason, you require the following knowledge: ● An understanding of the typical scenarios for the integration of financial data ● An understanding of how to make the Customizing settings that are necessary for integration ● An understanding of how to upload financial data from Project System (PS) to financial planning of a portfolio item LESSON OBJECTIVES After completing this lesson, you will be able to: ● Integrate financial data from Project System (PS) ● Integrate financial data from PS projects © Copyright. All rights reserved. 267
276.
7/26/2020 SAP e-book 1/1 Scenario
IT or Service Project Integration Figure 136: Example of IT Projects and Service Projects IT projects and service projects are often planned and implemented using Project Management. In PPM, appropriate portfolio items are then created, which are linked with the portfolio projects, and are used for a first rough planning of the required funds. For a detailed cost planning and for the posting of actual costs, the portfolio projects are linked with work breakdown structures from PS or, in the simplest case with internal orders from SAP Controlling. Depending on the setting of portfolio projects, these links to controlling objects are done automatically or manually. On the basis of the link, plan data of the portfolio projects, such as planned required capacities and costs or revenue rates is passed on to the linked controlling objects and used here for automatic cost and revenue planning. The plan data can now be supplemented at the level of controlling objects and budgeting can be performed. After the release of project parts in the implementation phase of the projects, the resources of the project can have automatic data, such as assigned tasks, implemented in the worklist of the time sheets Cross-Application Time Sheet (CATS). The resources can then use this information to confirm the work they have performed. The actual times that are confirmed in this manner can be passed back to the portfolio projects, and the actual costs are posted to the linked controlling objects. If other costs arise in the project execution due to external procurements, period-end closing activities, or revenues due to invoicing and customer invoices, then these are also posted to the Controlling objects. Using the FI/CO interface of PPM, you can now integrate all this accounting data of the linked controlling objects into the financial planning of the relevant portfolio items. This data can be compared with the financial planing data that was originally forecasted, and can be used to monitor projects continuously. SAP Financial Integration Using the financial planning in PPM, you forecast financial data for portfolio items and portfolio buckets in a very early phase of your projects. If detailed plan data is available later due to your project planning, it should also be possible to evaluate this data in the financial Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 268
277.
7/26/2020 SAP e-book 1/1 planning
of PPM and base decisions on it. You also require data about the actual costs incurred or commitments for monitoring and controlling in PPM, particularly in the implementation phase of the projects. To be able to evaluate detailed accounting data from FI/CO in PPM, use the FI/CO interface of PPM. Data Integrated Using the FI/CO Interface of the PPM Interface ● Planned costs ● Planned times ● Planned revenues ● Budget ● Commitments ● Actual costs ● Actual times ● Actual revenues Object Link of the Controlling Objects Figure 137: Object Link of the Controlling Objects The integration of accounting data is technically implemented using object links, similar to the integration of the project management data. This means that an object link is established between a portfolio item and a controlling object, which is then used to exchange accounting data. You can create this link using Object Links, which you navigate to through Relationships→ Object Links from a portfolio item. You can select the object type and the controlling object and assign it to the portfolio item. You can create object links to the following elements: ● Internal orders ● Network activity element ● Network Lesson: Integrating SAP Portfolio Management with SAP ERP Financial Data © Copyright. All rights reserved. 269
278.
7/26/2020 SAP e-book 1/1 ●
Network activity ● Network hierarchy ● Network activity hierarchy ● Project definition ● Service or maintenance order ● WBS element hierarchy ● WBS element If a suitable object link exists between the portfolio item and the controlling object, the uploading of data is controlled by a program that is usually scheduled as a background job in the PPM core system. The figure, Object Link of the Controlling Objects, illustrates how this program works. Program for FI/CO Integration Figure 138: Program for FI/CO Integration The program /RPM/FICO_INT_PLANNING is executed in the PPM core system or scheduled as a background job there. Based on the object links, the accounting data of the controlling objects are then determined from the FI/CO system, transported into the PPM system, and is saved here in the table RPM_FIDATA. The program requires the RFC destination of the SAP FI/CO system as a parameter. In the initial screen of the program, specify the identification of portfolio items for which the financial data is to be determined. In addition, specify the details for the accounting data, such as the CO version, which are to be used to determine the relevant data, or the exchange rate type that is to be used for currency translations if necessary. The execution of the program /RPM/FICO_INT_PLANNING depends on following execution parameters: ● Integration Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 270
279.
7/26/2020 SAP e-book 1/1 ●
Planning ● Rollup Scenario Large Project Integration Figure 139: Example of Large Projects This scenario involves the monitoring and controlling of large projects, such as construction projects, maintenance projects, or large research and development projects. In an early phase, portfolio items are created, critical success factors are determined and rough planning of required funds is performed in PPM. The projects are usually mapped in PS, since integration to Materials Management (MM), Production Planning (PP), Plant Maintenance (PM), Sales and Distribution (SD), Investment Management (IM) and Financial Accounting and Management Accounting (FI and CO) is generally required for detailed planning and execution. You can use the PS integration to evaluate structure data, scheduling data, or resource data of these projects directly in PPM. In doing so, data from the projects in PS is converted to Project Management data and uploaded to PPM. This integration is independent of the FI/CO integration. Customers, who are interested only in the accounting data of the projects, can use the FI/CO integration without having to upload structure data, scheduling data, or resource data to PPM. The projects in PS are used for cost planning, revenue planning, and budgeting. In particular, documents from various other applications result in commitment, actual costs, and actual revenues. Using the FI/CO interface, this data can be passed on to the portfolio items to which the projects were assigned and compared here with the original financial planning. Lesson: Integrating SAP Portfolio Management with SAP ERP Financial Data © Copyright. All rights reserved. 271
280.
7/26/2020 SAP e-book 1/1 Hint: Financial
data from subordinate FI/CO systems is therefore integrated into portfolio items. From there, this data can be rolled up further to initiatives or initiatives and portfolio buckets. The rollup of data is independent of the FI/CO integration. It would be equally possible to roll up manual planning data from portfolio items to initiatives or initiatives and portfolio buckets. Currency Conversion In PPM, you can specify a financial planning currency for items, buckets and initiatives. Valid currencies are predefined in Customizing. During financial planning, you can switch between different currencies so that a currency conversion can take place. Conversion rates are maintained in a separate SAP ERP system. Currency Conversion Conditions Whether a currency conversion takes place or not depends on the following conditions: ● Has the value been transferred from SAP ERP? ● Is the value available in the requested currency? (controlling area currency or item currency are saved for items) If both the answers are yes, the values are taken from SAP ERP. If one of the answers is no, currency conversion takes place. LESSON SUMMARY You should now be able to: ● Integrate financial data from Project System (PS) ● Integrate financial data from PS projects Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 272
281.

7/26/2020 SAP e-book 1/1 Unit
8 Lesson 5 Integrating SAP Innovation Management LESSON OVERVIEW The lesson explains the new SAP Innovation Management application which can be used in SAP PPM by linking portfolio items to SAP Innovation Management. Business Example Innovation is vital to you company’s growth and success. The challenge lies in harnessing innovation in a way that delivers profitable outcomes and optimizes your investment in research and development. SAP Innovation Management software helps you foster innovation, capture it, and rapidly convert it into industry-leading, value-generating initiatives. LESSON OBJECTIVES After completing this lesson, you will be able to: ● Explain integration to SAP Innovation Management SAP Innovation Management Integration The success of a company depends on its capability to develop innovative products, services or business models. This capability requires a culture of creativity and innovation, where employees share and discuss their ideas both with colleagues and with management. However, these ideas need to be systematically managed, which means that they are evaluated and filtered according to a predefined process to extract the most promising ones. SAP Innovation Management helps you to foster a culture of innovation by offering a platform where employees can easily present their own ideas and discuss the ideas of others. SAP Innovation Management also enables you to run campaigns for systematically collecting ideas and to manage the ideas according to a predefined and adaptable innovation process. The innovation process is composed of a number of phases, through which the ideas are guided by idea coaches and which include evaluations by experts. These are continued by conceptual work within innovation projects and the inclusion into products and successful market introduction. © Copyright. All rights reserved. 273
282.
7/26/2020 SAP e-book 1/1 Figure
140: SAP Innovation Management SAP Innovation Management is has the following basic parts: ● Idea community ● Innovation office ● Mobile web app The idea community is the platform for all employees to create, share and, discuss their ideas and to participate in idea campaigns. Here, employees can view campaigns, browse through ideas, and comment or vote on ideas. If they want to share their own ideas, they can submit them. Notifications keep them informed about how their ideas progress along the innovation process. The idea community is also the place where subject matter experts evaluate ideas. Unlike the idea community, which is accessible for all users of SAP Innovation Management, the innovation office is a back office for specialists working professionally with ideas and campaigns. Campaign managers set up and monitor campaigns, idea coaches process the ideas of a campaign, innovation managers administer users, configure phases and evaluation methods for campaigns and more. The mobile web app is for users of SAP Innovation Management who want to use their mobile devices to quickly create an idea draft, check their notifications, or explore idea lists and campaigns when on the move. Object Link for Innovation Management With the latest release of PPM a new object link is provided for SAP Innovation Management as the preferred solution to explore, evaluate and manage ideas in the innovation process. Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 274
283.
7/26/2020 SAP e-book 1/1 Figure
141: Object Link in Portfolio Item You can link Ideas of the HANA XS based SAP Innovation Management application to portfolio items and retrieve idea information as Idea ID and Name, Submitter, Coach, Campaign, Phase and Status in the object details. The forward navigation from PPM to SAP Innovation Management supports cross-application PLM processes. The Innovation Management Idea in turn retrieves information about the linked object (for example, about dates) responsible for a task or the active decision point of an item. There are two options to navigate to the linked Idea: Innovation Community and Innovation Office both display the linked Idea but in a different context. The creation of a link to an Idea follows the general steps for object links. It is possible to search for Ideas using the Idea Name or ID, a Campaign or the completed flag. From the hit list of Ideas that meet the criteria, the user can select multiple Ideas to create multiple object links. The customizing for the corresponding object type 0RPMIDEA in portfolio management is done in the same manner as for the other existing object types for object links. Lesson: Integrating SAP Innovation Management © Copyright. All rights reserved. 275
284.

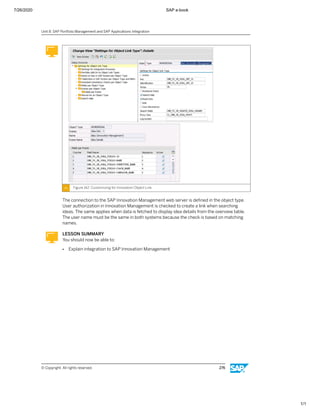

7/26/2020 SAP e-book 1/1 Figure
142: Customizing for Innovation Object Link The connection to the SAP Innovation Management web server is defined in the object type. User authorization in Innovation Management is checked to create a link when searching ideas. The same applies when data is fetched to display idea details from the overview table. The user name must be the same in both systems because the check is based on matching names. LESSON SUMMARY You should now be able to: ● Explain integration to SAP Innovation Management Unit 8: SAP Portfolio Management and SAP Applications Integration © Copyright. All rights reserved. 276
285.
7/26/2020 SAP e-book 1/1 Unit

8 Learning Assessment 1. Which of the following objects of Project System can be linked to objects of SAP Portfolio and Project Management (PPM)? Choose the correct answers. X A Project definition X B Networks X C WBS elements X D Activity 2. You can synchronize attributes but not statuses of WBS elements and portfolio items. Determine whether this statement is true or false. X True X False 3. When you perform global customizing of Portfolio Management, you link decision points of item types or item templates to WBS elements. Determine whether this statement is true or false. X True X False 4. Object links are defined in the standard SAP system for the integration of accounting data from internal orders and projects of Project System. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 277
286.
7/26/2020 SAP e-book 1/1 5.
Which of the following data can be integrated by using the FI/CO interface of the PPM interface? Choose the correct answers. X A Planned costs X B Planned times X C Resources X D Planned revenues 6. In PPM, only plan costs of appended orders are integrated with portfolio items. Determine whether this statement is true or false. X True X False Unit 8: Learning Assessment © Copyright. All rights reserved. 278
287.
7/26/2020 SAP e-book 1/1 Unit

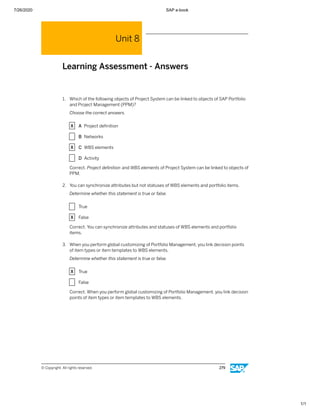

8 Learning Assessment - Answers 1. Which of the following objects of Project System can be linked to objects of SAP Portfolio and Project Management (PPM)? Choose the correct answers. X A Project definition X B Networks X C WBS elements X D Activity Correct. Project definition and WBS elements of Project System can be linked to objects of PPM. 2. You can synchronize attributes but not statuses of WBS elements and portfolio items. Determine whether this statement is true or false. X True X False Correct. You can synchronize attributes and statuses of WBS elements and portfolio items. 3. When you perform global customizing of Portfolio Management, you link decision points of item types or item templates to WBS elements. Determine whether this statement is true or false. X True X False Correct. When you perform global customizing of Portfolio Management, you link decision points of item types or item templates to WBS elements. © Copyright. All rights reserved. 279
288.
7/26/2020 SAP e-book 1/1 4.
Object links are defined in the standard SAP system for the integration of accounting data from internal orders and projects of Project System. Determine whether this statement is true or false. X True X False Correct. Object links are defined in the standard SAP system for the integration of accounting data from internal orders and projects of Project System. 5. Which of the following data can be integrated by using the FI/CO interface of the PPM interface? Choose the correct answers. X A Planned costs X B Planned times X C Resources X D Planned revenues Correct. Planned Costs, Planned times and Planned revenues can be integrated by using the FI/CO interface of the PPM interface. 6. In PPM, only plan costs of appended orders are integrated with portfolio items. Determine whether this statement is true or false. X True X False Correct. In PPM, only plan costs of appended orders are integrated with portfolio items. Unit 8: Learning Assessment - Answers © Copyright. All rights reserved. 280
289.
7/26/2020 SAP e-book 1/1 UNIT
9 Key Figures Lesson 1 Using Questionnaires 282 Lesson 2 Using Scoring Models 286 UNIT OBJECTIVES ● Create a questionnaire ● Apply a questionnaire for a portfolio item ● Create a scoring model ● Apply a scoring model for a portfolio item © Copyright. All rights reserved. 281
290.
7/26/2020 SAP e-book 1/1 Unit
9 Lesson 1 Using Questionnaires LESSON OVERVIEW This lesson shows you how to configure a questionnaires in SAP Portfolio and Project Management. Business Example You want to make it easier for your item managers to estimate critical success factors such as the probability of technical success of a project. Therefore, you want to create a questionnaire so that you can use the responses to determine the probability of technical success. For this reason, you require the following knowledge: ● An understanding of questionnaires ● An understanding of how to use questionnaires LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create a questionnaire ● Apply a questionnaire for a portfolio item Questionnaire Portfolio item fields, such as the probabilities of technical success or the assessed project risk are important criteria for the assessment or comparison of portfolio items. It is difficult to manually enter a numerical value directly in these fields, and without additional details, it is difficult to trace this later. Using questionnaires, you can derive the values of these fields from qualitative standardized criteria and analyze the derivation of the field values later, instead of entering the values manually. Hint: Questionnaires can be created for fields in portfolio initiatives and decision points, as well as for fields in portfolio items. The procedure is exactly the same as for maintaining questionnaires for portfolio items. This lesson focuses on questionnaires for fields of a portfolio item. © Copyright. All rights reserved. 282
291.

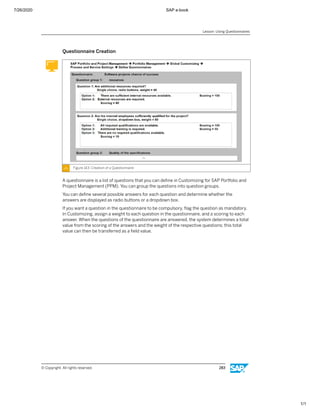

7/26/2020 SAP e-book 1/1 Questionnaire
Creation Figure 143: Creation of a Questionnaire A questionnaire is a list of questions that you can define in Customizing for SAP Portfolio and Project Management (PPM). You can group the questions into question groups. You can define several possible answers for each question and determine whether the answers are displayed as radio buttons or a dropdown box. If you want a question in the questionnaire to be compulsory, flag the question as mandatory. In Customizing, assign a weight to each question in the questionnaire, and a scoring to each answer. When the questions of the questionnaire are answered, the system determines a total value from the scoring of the answers and the weight of the respective questions; this total value can then be transferred as a field value. Lesson: Using Questionnaires © Copyright. All rights reserved. 283
292.
7/26/2020 SAP e-book 1/1 Assignment
of the Questionnaire to a Field in a Portfolio Item Figure 144: Assigning of the Questionnaire to a Field in a Portfolio Item After you define a questionnaire in Customizing for PPM, assign it to the field in which the questionnaire is available. To do this, the field service questionnaire must be assigned to the field in the field configuration. The PPM administrator assigns the questionnaire to a field of the portfolio item at the level of the portfolio bucket, which is directly superior in the section Field Service Configuration. In the section Field Service Configuration, the system displays only fields with a Field Service Configuration that allows a corresponding service. Unit 9: Key Figures © Copyright. All rights reserved. 284
293.
7/26/2020 SAP e-book 1/1 Questionnaire
for a Portfolio Item Figure 145: Example of a Questionnaire The figure, Example of a Questionnaire, displays how a questionnaire can look in SAP PPM. In this example, the options for the first question are displayed as radio buttons, and the options for the second question are displayed as a dropdown box. The outcome of the questionnaire is the value for the field Probability of Technical Success . It is a result of the total scores of the individual answers, weighted correspondingly with the weight of the questions, and divided by the total of all weights. Using the Questionnaires link, you can view all filled questionnaires for a portfolio item. With this, you can analyze when and by whom the questionnaires were last answered, and how the results are composed from the scoring of the answers and the weights of the questions. LESSON SUMMARY You should now be able to: ● Create a questionnaire ● Apply a questionnaire for a portfolio item Lesson: Using Questionnaires © Copyright. All rights reserved. 285
294.
7/26/2020 SAP e-book 1/1 Unit
9 Lesson 2 Using Scoring Models LESSON OVERVIEW This lesson shows you how to configure scoring models in SAP Portfolio and Project Management. It also explains how to use them to derive field values in portfolio items. Business Example Fields of portfolio items, such as the upper limit for the risk of a project, is derived from other fields, such as the probability of success and the development costs. You want to define a suitable scoring model for this derivation. For this reason, you require the following knowledge: ● An understanding of how to use scoring models to derive field values LESSON OBJECTIVES After completing this lesson, you will be able to: ● Create a scoring model ● Apply a scoring model for a portfolio item Scoring Models Scoring models are used in PPM for two different purposes. Scoring models can be used as a field service to derive the value of fields (such as the probabilities of technical success or the assessed project risk) from the values of other fields. You can apply scoring models for portfolio items or initiatives. Scoring models can also be used in reviews to compare and prioritize various portfolio items based on defined fields and their scoring. This lesson deals with the use of scoring models as a field service for portfolio items. © Copyright. All rights reserved. 286
295.

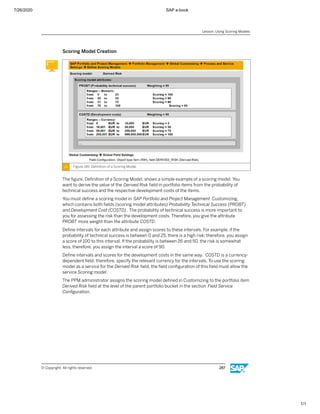

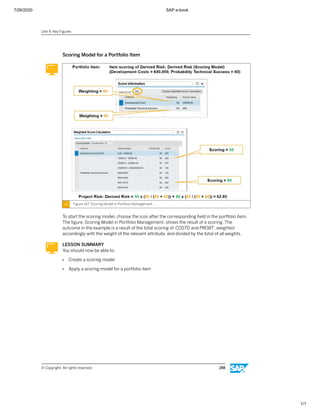

7/26/2020 SAP e-book 1/1 Scoring
Model Creation Figure 146: Definition of a Scoring Model The figure, Definition of a Scoring Model, shows a simple example of a scoring model. You want to derive the value of the Derived Risk field in portfolio items from the probability of technical success and the respective development costs of the items. You must define a scoring model in SAP Portfolio and Project Management Customizing, which contains both fields (scoring model attributes) Probability Technical Success (PROBT) and Development Cost (COSTD) . The probability of technical success is more important to you for assessing the risk than the development costs. Therefore, you give the attribute PROBT more weight than the attribute COSTD. Define intervals for each attribute and assign scores to these intervals. For example, if the probability of technical success is between 0 and 25, there is a high risk; therefore, you assign a score of 100 to this interval. If the probability is between 26 and 50, the risk is somewhat less; therefore, you assign the interval a score of 90. Define intervals and scores for the development costs in the same way. COSTD is a currency- dependent field; therefore, specify the relevant currency for the intervals. To use the scoring model as a service for the Derived Risk field, the field configuration of this field must allow the service Scoring model. The PPM administrator assigns the scoring model defined in Customizing to the portfolio item Derived Risk field at the level of the parent portfolio bucket in the section Field Service Configuration. Lesson: Using Scoring Models © Copyright. All rights reserved. 287
296.
7/26/2020 SAP e-book 1/1 Scoring
Model for a Portfolio Item Figure 147: Scoring Model in Portfolio Management To start the scoring model, choose the icon after the corresponding field in the portfolio item. The figure, Scoring Model in Portfolio Management, shows the result of a scoring. The outcome in the example is a result of the total scoring of COSTD and PROBT, weighted accordingly with the weight of the relevant attribute, and divided by the total of all weights. LESSON SUMMARY You should now be able to: ● Create a scoring model ● Apply a scoring model for a portfolio item Unit 9: Key Figures © Copyright. All rights reserved. 288
297.

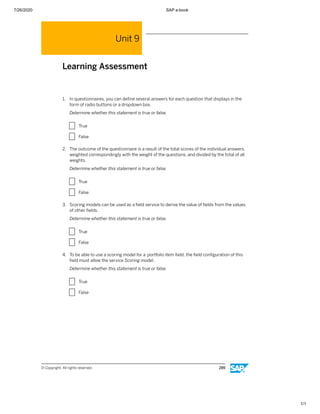

7/26/2020 SAP e-book 1/1 Unit
9 Learning Assessment 1. In questionnaires, you can define several answers for each question that displays in the form of radio buttons or a dropdown box. Determine whether this statement is true or false. X True X False 2. The outcome of the questionnaire is a result of the total scores of the individual answers, weighted correspondingly with the weight of the questions, and divided by the total of all weights. Determine whether this statement is true or false. X True X False 3. Scoring models can be used as a field service to derive the value of fields from the values of other fields. Determine whether this statement is true or false. X True X False 4. To be able to use a scoring model for a portfolio item field, the field configuration of this field must allow the service Scoring model. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 289
298.
7/26/2020 SAP e-book 1/1 Unit
9 Learning Assessment - Answers 1. In questionnaires, you can define several answers for each question that displays in the form of radio buttons or a dropdown box. Determine whether this statement is true or false. X True X False Correct. You can define several possible answers for each question in a questionnaire and determine whether the answers are displayed in the form of radio buttons or a dropdown box. 2. The outcome of the questionnaire is a result of the total scores of the individual answers, weighted correspondingly with the weight of the questions, and divided by the total of all weights. Determine whether this statement is true or false. X True X False Correct. The outcome of the questionnaire is a result of the total scores of the individual answers, weighted correspondingly with the weight of the questions, and divided by the total of all weights. 3. Scoring models can be used as a field service to derive the value of fields from the values of other fields. Determine whether this statement is true or false. X True X False Correct. Scoring models can be used as a field service to derive the value of fields from the values of other fields. © Copyright. All rights reserved. 290
299.
7/26/2020 SAP e-book 1/1 4.
To be able to use a scoring model for a portfolio item field, the field configuration of this field must allow the service Scoring model. Determine whether this statement is true or false. X True X False Correct. To be able to use a scoring model for a portfolio item field, the field configuration of this field must allow the service Scoring model. Unit 9: Learning Assessment - Answers © Copyright. All rights reserved. 291
300.
7/26/2020 SAP e-book 1/1 UNIT
10 Reports Lesson 1 Reporting with SAP Analytics Cloud 293 Lesson 2 Reporting with Dashboards 295 Lesson 3 Reporting Based on Business Context Viewer (BCV) 300 Lesson 4 Configuring Business Context Viewer (BCV) Content 306 UNIT OBJECTIVES ● Explain how to use SAP Analytics Cloud ● Use dashboards for reporting ● Outline the configuration of dashboards ● Use BCV for buckets and items ● Outline the architecture of BCV ● Configure BCV content © Copyright. All rights reserved. 292
301.
7/26/2020 SAP e-book 1/1 Unit
10 Lesson 1 Reporting with SAP Analytics Cloud LESSON OBJECTIVES After completing this lesson, you will be able to: ● Explain how to use SAP Analytics Cloud SAP Analytics Cloud Using intelligent technologies like SAP Analytics Cloud enables your organization to evaluate both internal and external data to predict business outcomes. Optimizing the day to day is important, but intelligence and new technologies can have massive impacts on influencing the unknown. Big strategic decisions on company direction, where to invest, and expanding into new markets require a different view on data. With SAP Analytics Cloud, organizations can reduce the amount of uncertainty associated with the future and drive strategic decisions. From the initial stages of an analytics project, SAP Analytics Cloud delivers immediate value, with smart features and content to get you started: ● Built-in connectors to data sources ● Intelligent algorithms highlighting possible data quality issues and distributing your data ● Smart transformations enabling you to quickly address and solve data quality issues ● A growing library of business content created across 15+ industries and 27+ lines of business Figure 148: SAP Analytics Cloud Overview © Copyright. All rights reserved. 293
302.
7/26/2020 SAP e-book 1/1 You
use SAP Analytics Cloud to obtain a fast overview of the data of portfolio items, initiatives, and projects. LESSON SUMMARY You should now be able to: ● Explain how to use SAP Analytics Cloud Unit 10: Reports © Copyright. All rights reserved. 294
303.
7/26/2020 SAP e-book 1/1 Unit
10 Lesson 2 Reporting with Dashboards LESSON OVERVIEW This lesson shows how to use dashboards for a tabular reporting of objects in SAP Portfolio and Project Management. It also shows how to adjust them to your requirements. Business Example You use item dashboards to obtain a fast overview of the data of portfolio items. To use the dashboards effectively, you want to familiarize yourself with the various functions and Customizing options of dashboards. For this reason, you require the following knowledge: ● An understanding of how to use the dashboards ● An understanding of how to interpret status icons of dashboards ● An understanding of how to use customizing and personalization options of dashboards LESSON OBJECTIVES After completing this lesson, you will be able to: ● Use dashboards for reporting ● Outline the configuration of dashboards Dashboards Figure 149: Item Dashboard © Copyright. All rights reserved. 295

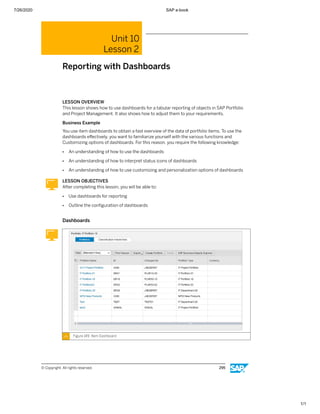

304.
7/26/2020 SAP e-book 1/1 Flexible
dashboards in SAP Portfolio and Project Management (PPM) help you to keep a close eye on all activities through a detailed view for field managers and a summary view for top executives. Among available displays are those for drilling down to the project status and comparing planned budgets, actual budgets, and deadlines. Dashboards in PPM facilitate staffing tasks, cost, and risk analysis. Dashboards support earned value management by helping you calculate expected commercial value. PPM offers a variety of dashboards for different objects, such as buckets, items, portfolio initiatives, reviews, and collections. The use of dashboards is now explained in more detail using the item dashboard as an example. Dashboards can be used to analyze master data, financial data, staffing status, and any other kind of information with respect to your items. In addition to the analysis of data, dashboards provide the following features: ● Create one or more new objects ● Delete objects ● Mass update ● Move objects to another bucket ● Sort ● Advanced filter ● Personalize dashboard ● Export to Microsoft Excel For the item dashboard, you can select several views, such as all items, active items, active proposals, active escalations, and inactive items. An item is inactive if it has a status that was assigned to the status group 0500 Cancelled or 0700 Completed in the portfolio item type definition. All other portfolio items are interpreted as active. An item is escalated if you activate the respective indicator. An item appears as a proposed item depending on the item type and decision point settings. Unit 10: Reports © Copyright. All rights reserved. 296
305.

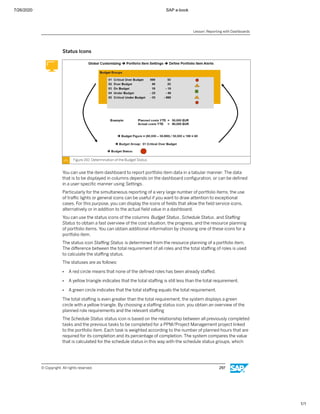

7/26/2020 SAP e-book 1/1 Status

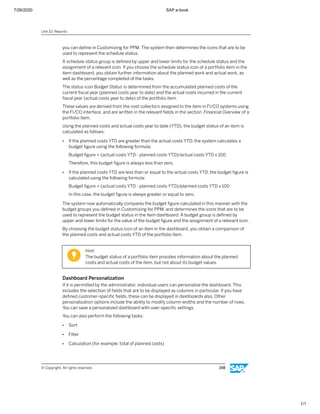

Icons Figure 150: Determination of the Budget Status You can use the item dashboard to report portfolio item data in a tabular manner. The data that is to be displayed in columns depends on the dashboard configuration, or can be defined in a user-specific manner using Settings. Particularly for the simultaneous reporting of a very large number of portfolio items, the use of traffic lights or general icons can be useful if you want to draw attention to exceptional cases. For this purpose, you can display the icons of fields that allow the field service icons, alternatively or in addition to the actual field value in a dashboard. You can use the status icons of the columns Budget Status, Schedule Status, and Staffing Status to obtain a fast overview of the cost situation, the progress, and the resource planning of portfolio items. You can obtain additional information by choosing one of these icons for a portfolio item. The status icon Staffing Status is determined from the resource planning of a portfolio item. The difference between the total requirement of all roles and the total staffing of roles is used to calculate the staffing status. The statuses are as follows: ● A red circle means that none of the defined roles has been already staffed. ● A yellow triangle indicates that the total staffing is still less than the total requirement. ● A green circle indicates that the total staffing equals the total requirement. The total staffing is even greater than the total requirement, the system displays a green circle with a yellow triangle. By choosing a staffing status icon, you obtain an overview of the planned role requirements and the relevant staffing The Schedule Status status icon is based on the relationship between all previously completed tasks and the previous tasks to be completed for a PPM/Project Management project linked to the portfolio item. Each task is weighted according to the number of planned hours that are required for its completion and its percentage of completion. The system compares the value that is calculated for the schedule status in this way with the schedule status groups, which Lesson: Reporting with Dashboards © Copyright. All rights reserved. 297
306.
7/26/2020 SAP e-book 1/1 you
can define in Customizing for PPM. The system then determines the icons that are to be used to represent the schedule status. A schedule status group is defined by upper and lower limits for the schedule status and the assignment of a relevant icon. If you choose the schedule status icon of a portfolio item in the item dashboard, you obtain further information about the planned work and actual work, as well as the percentage completed of the tasks. The status icon Budget Status is determined from the accumulated planned costs of the current fiscal year (planned costs year to date) and the actual costs incurred in the current fiscal year (actual costs year to date) of the portfolio item. These values are derived from the cost collectors assigned to the item in FI/CO systems using the FI/CO interface, and are written in the relevant fields in the section Financial Overview of a portfolio item. Using the planned costs and actual costs year to date (YTD), the budget status of an item is calculated as follows: ● If the planned costs YTD are greater than the actual costs YTD, the system calculates a budget figure using the following formula: Budget figure = (actual costs YTD - planned costs YTD)/actual costs YTD x 100 Therefore, this budget figure is always less than zero. ● If the planned costs YTD are less than or equal to the actual costs YTD, the budget figure is calculated using the following formula: Budget figure = (actual costs YTD - planned costs YTD)/planned costs YTD x 100 In this case, the budget figure is always greater or equal to zero. The system now automatically compares the budget figure calculated in this manner with the budget groups you defined in Customizing for PPM, and determines the icons that are to be used to represent the budget status in the item dashboard. A budget group is defined by upper and lower limits for the value of the budget figure and the assignment of a relevant icon. By choosing the budget status icon of an item in the dashboard, you obtain a comparison of the planned costs and actual costs YTD of the portfolio item. Hint: The budget status of a portfolio item provides information about the planned costs and actual costs of the item, but not about its budget values. Dashboard Personalization If it is permitted by the administrator, individual users can personalize the dashboard. This includes the selection of fields that are to be displayed as columns in particular. If you have defined customer-specific fields, these can be displayed in dashboards also. Other personalization options include the ability to modify column widths and the number of rows. You can save a personalized dashboard with user-specific settings. You can also perform the following tasks: ● Sort ● Filter ● Calculation (for example, total of planned costs) Unit 10: Reports © Copyright. All rights reserved. 298
307.
7/26/2020 SAP e-book 1/1 You
can predefine and save these settings as well. Dashboard Configuration Figure 151: Dashboard Configuration You can configure dashboards in Customizing. For example, you want to add a customer field to a dashboard. The figure, Dashboard Configuration, displays three possible Customizing activities for dashboards. First of all, fields per dashboard type are defined. You can enter customer fields or metrics for specific dashboards. You can set up additional scopes, such as content of tab pages for dashboards. Finally, you can specify personalization options. LESSON SUMMARY You should now be able to: ● Use dashboards for reporting ● Outline the configuration of dashboards Lesson: Reporting with Dashboards © Copyright. All rights reserved. 299
308.
7/26/2020 SAP e-book 1/1 Unit
10 Lesson 3 Reporting Based on Business Context Viewer (BCV) LESSON OVERVIEW This lesson describes reporting based on Business Context Viewer (BCV). It lists different reports, the navigation in reports, and personalization options for reports. Business Example In SAP Portfolio and Project Management, your company manages about 500 items so far. You can use dashboards based on lists to analyze the items. However, you want to use graphics like portfolio graphics or Gantt charts to analyze your portfolio. For this reason, you require the following knowledge: ● An understanding of how to analyze items and buckets by reports ● An understanding of how to personalize reports based on BCV LESSON OBJECTIVES After completing this lesson, you will be able to: ● Use BCV for buckets and items ● Outline the architecture of BCV Business Context Viewer (BCV) In PPM, you can analyze various objects like items, buckets, and portfolio initiatives. For reporting, you can use different reports like timeline monitor and different types of charts and tables. These reports are based on different techniques, such as BI reports, GANTT Charts based on Java, and queries based on BCV. In this lesson, we focus on BCV-based reports. BCV is a standard framework to show context-related information for Business Suite applications. A benefit of BCV is that you can display context-related information in a side panel. However, PPM is just one of multiple Business Suite applications that use BCV. © Copyright. All rights reserved. 300
309.
7/26/2020 SAP e-book 1/1 Reporting
Cockpits Figure 152: Reporting Cockpit for Dashboards You can use reporting cockpits for dashboards and individual items. Reporting cockpits in dashboards provide information about the following: ● Expected Commercial Value (ECV) ● Schedule ● Risk versus reward Lesson: Reporting Based on Business Context Viewer (BCV) © Copyright. All rights reserved. 301
310.

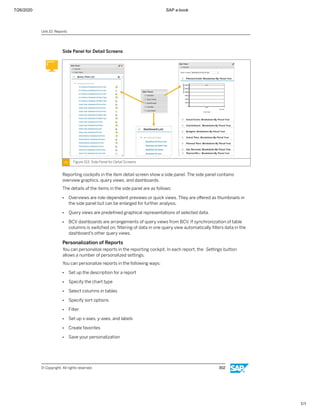

7/26/2020 SAP e-book 1/1 Side
Panel for Detail Screens Figure 153: Side Panel for Detail Screens Reporting cockpits in the item detail screen show a side panel. The side panel contains overview graphics, query views, and dashboards. The details of the items in the side panel are as follows: ● Overviews are role-dependent previews or quick views. They are offered as thumbnails in the side panel but can be enlarged for further analysis. ● Query views are predefined graphical representations of selected data. ● BCV dashboards are arrangements of query views from BCV. If synchronization of table columns is switched on, filtering of data in one query view automatically filters data in the dashboard's other query views. Personalization of Reports You can personalize reports in the reporting cockpit. In each report, the Settings button allows a number of personalized settings. You can personalize reports in the following ways: ● Set up the description for a report ● Specify the chart type ● Select columns in tables ● Specify sort options ● Filter ● Set up x-axes, y-axes, and labels ● Create favorites ● Save your personalization Unit 10: Reports © Copyright. All rights reserved. 302
311.
7/26/2020 SAP e-book 1/1 BCV
Architecture Figure 154: BCV Architecture and Roles BCV has an architecture that separates the configuration from the graphical representation in the front-end application. An administrator creates analytics content by defining the data provider, and setting up BCV queries and query views based on this data. By defining query view lists, overviews, and dashboards, the administrator can arrange this analytical information in the BCV front-end application. The administrators can be split by applications to have a decentralized approach. The end user (in this case, a portfolio manager or a project manager) can show context- related analytics with BCV front end through the side panel, BCV dashboard, or analytic view. Prerequisites for BCV Reporting A prerequisite for reporting based on BCV is that a specific role must be assigned to the user. In the standard delivery, you can assign the composite role SAP_RPM_BCV_USER_COMP. You can assign a user to a role with transaction PFCG. Alternatively, you can assign a role to a user with transaction SU01. There are a number of technical prerequisites. For example, the SAP Business Suite Foundation must be implemented. Check the master guide for PPM for details. SAP Fiori SAP Fiori is the new user experience (UX) for SAP software that applies modern design principles. SAP solutions, for example the SAP Business Suite powered by SAP HANA, use the SAP Fiori UX to provide a personalized, responsive, and simple user experience. Lesson: Reporting Based on Business Context Viewer (BCV) © Copyright. All rights reserved. 303
312.
7/26/2020 SAP e-book 1/1 Figure
155: Simplification and New User Experience SAP Fiori UX speaks a consistent design language and makes use of a common technical infrastructure. By blurring traditional computing boundaries and by using interactive and attractive UI elements, SAP Fiori UX provides a consistent end-to-end user experience and can be used across all device types, for example, desktop, tablet, and mobile. Organized by user roles, the SAP Fiori launchpad is the central entry hub to all SAP Fiori apps, where users access apps via tiles. Within the launchpad, there are services for navigation, personalization, single sign-on, and search. The launchpad and the tiles are flexible and can be adapted to your needs. You can use the search in the SAP Fiori launchpad to search for business objects and for apps. Apps applying the SAP Fiori UX focus on the following critical and common activities and are designed around how people work: ● Role-based: Designed for you, your needs, and how you work. ● Responsive: Supports how and where you work, at any time. ● Simple: Focuses on the important. ● Coherent: Provides one fluid, seamless experience. ● Delightful: Makes an emotional connection All UIs are built with HTML5 and SAP UI5 mobile. SAP Fiori apps allow you to access the most recent version of your back end data via OData services. Using previously defined roles and authorizations, you can specify which apps and which data a user is allowed to access. SAP Fiori also offers a bundle of transactional apps for PPM that run on the SAP Fiori launchpad. The apps consist of front-end components (such as the user interfaces) and back- end components (such as the OData service). The back-end components and the front-end components are delivered in separate products and have to be installed in a system landscape that is enabled for SAP Fiori. Unit 10: Reports © Copyright. All rights reserved. 304
313.
7/26/2020 SAP e-book 1/1 Change
Portfolio Items With the transactional app Change Portfolio Items, program managers can change basic data, post notes, and view portfolio item documents. The following is a list of the key features of Change Portfolio Items: ● Display a list of all portfolio items that can be changed (portfolio items that are not in the end status); display data of portfolio items. ● Change the data of portfolio items. ● Group or sort the entries in the list of portfolio items. ● Search for portfolio items in the portfolio items list. ● Display notes or add new notes to portfolio items; contact the creators of notes. ● Add attachments to portfolio items; display or delete attachments assigned to portfolio items. ● Share notes and attachments referring to portfolio items via SAP JAM groups to discuss with other group members. Change Portfolio Items Proposals With the transactional app Create Portfolio Item Proposals program managers can create proposals for new portfolio items. Once a proposal is completed, the program manager can send it to start the reviewing process. The following is a list of the key features of Change Portfolio Items Proposals: ● Display a list of all portfolio item proposals (portfolio items in start status); display details of portfolio items. ● Search for portfolio items in the portfolio items list. ● Group or sort the entries in the list of portfolio items. ● Create, edit, or delete new portfolio item proposals. ● Select the relevant portfolios and buckets from lists when creating a new proposal. ● Add notes to portfolio items. ● Add attachments to portfolio items; display or delete attachments assigned to portfolio items. ● Send portfolio item proposals for review. ● Share notes and attachments referring to portfolio item proposals via SAP JAM groups to discuss with other group members. LESSON SUMMARY You should now be able to: ● Use BCV for buckets and items ● Outline the architecture of BCV Lesson: Reporting Based on Business Context Viewer (BCV) © Copyright. All rights reserved. 305
314.
7/26/2020 SAP e-book 1/1 Unit
10 Lesson 4 Configuring Business Context Viewer (BCV) Content LESSON OVERVIEW Business Example You also want to report portfolio items together, which are assigned to different buckets of your portfolio, in the reporting of SAP RPM. For this purpose, you combine these portfolio items into collections according to your requirements. You use a reporting cockpit in SAP RPM to obtain a current overview of the key figures of various portfolio items. As an administrator, you need to provide the required technical objects that project managers require to analyze the data related to the project, including search connectors, queries, views, dashboards and launchpads LESSON OBJECTIVES After completing this lesson, you will be able to: ● Configure BCV content BCV Content Configuration Collections You use the portfolio structure is the hierarchical structuring of a portfolio in portfolio buckets. You use the portfolio structure to group the portfolio items based on responsibilities, organizational points of view, or product families. As well as the vertical structuring of a portfolio, you can view horizontal grouping of portfolio items for reporting and management purposes. This horizontal grouping of portfolio items, referred to as collections in SAP Portfolio and Project Management (PPM), enables you to combine items of different portfolio buckets and manage and analyze them together. You can create collections and assign portfolio items to the individual collections according to your requirements, for example, according to temporal or geographical points of view or other content. Hint: You can assign a portfolio item to several collections. A collection can only include the portfolio items of a single portfolio. Cross-portfolio reporting using collections is not possible. When you create a collection, you must first select the portfolio bucket to assign your collection. The system allows you to select from the list of the lowest buckets of your portfolios. In the detail screen of the collection, you must assign a name and an identification to the collection by default. If required, you can also add a more detailed description and © Copyright. All rights reserved. 306
315.
7/26/2020 SAP e-book 1/1 comments.
Since the collection is assigned to a portfolio bucket, the authorizations of the bucket are inherited by the collections. You can also change the authorizations for the collection if required. To report capacity planning data and financial planning data of assigned portfolio items, define the capacity unit and currency for reporting in the collection. You can assign portfolio items to the collection on the items in Collection tab page. You use the search screen to search for the relevant portfolio items. As search criteria, for example, you can use the names, identifications, schedules, locations, areas, categories, or also the estimated project risk by default. You can only assign to the collection portfolio, items that belong to the same portfolio as the collection itself. The figure, Collection of Portfolio Items, shows the detail screen of a collection. Figure 156: Collection of Portfolio Items After you have created a collection, you can analyze and manage the portfolio items that you assigned to the collection, or call a reporting cockpit for the items of the collection for further reporting. There are no settings required in Customizing of PPM for the creation of collections, apart from the assignment of required links or link groups to the portfolio type. Configuration Centre You use the configuration center as a central point of entry for Business Context Viewer (BCV) configuration and administration. You can define, edit, display and delete search connectors, queries, query views and all other BCV objects in the configuration center. You can also perform authorization and consistency checks, test search connectors and queries, and create, display, maintain, or delete access control lists (ACLs). On the starting page of the configuration center, the system groups BCV objects according to their type (for example, in the case of search connectors), and according to other criteria (for example, favorites and last used). Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 307
316.
7/26/2020 SAP e-book 1/1 Figure
157: Configuration Center Hint: Some of the functions of the configuration center are also available in Customizing. SAP recommends that you use the configuration center for all your BCV configuration and administration activities, for the following reasons: ● Not all of the functions of the configuration center are available in Customizing. ● The system locks all settings of the same type for other users if one user edits them in Customizing. ● Customizing is intended for administrators and advanced users to check and maintain settings, build own business configuration (BC) sets. You can access the configuration center from your user menu by accessing the corresponding entry in the BCV user role. You can only configure BCV when the following applies: ● You have activated the FND, Business Context Viewer Main Application /BCV/MAIN business function, and any business functions that are its prerequisites. ● You have the necessary authorizations, which are granted to you in one of the following ways: - In the Role Maintenance (PFCG) transaction, you are assigned to the BCV Administrator (SAP_BCV_ADMIN) role. - On the SAP NetWeaver Portal, you are assigned to the BCV Administrator (com.sap.pct.bs_fnd.BCV_ADMIN) role. Context Key You use the context key to specify a combination of application and business object. This distinguishes the configuration of BCV in your application from any other configurations that might exist in the system. Unit 10: Reports © Copyright. All rights reserved. 308
317.
7/26/2020 SAP e-book 1/1 As
BCV is an application that several other applications can use at the same time in the same system, it is necessary to separate the configuration settings of the individual applications. The context key identifies the application using BCV and the business object it processes. When the application uses BCV in several instances, you must include the identifier of the business object in the context key. If the application uses a namespace, the context key must start with this namespace. In this case, the namespace serves as the identifier for the application. The context key influences the way the business objects in BCV, for example queries and query views present data. Table 3: BCV Objects The following table describes this influence on the different BCV objects: BCV Data Influences of the Context Key Search Connector No influence. You can use any search connector in any application with any context key. This approach supports the reuse of search connectors. You can restrict the visibility of data by applying the necessary authorization restrictions. For more information, see Authorization Concept in BCV. Query You can assign a query to one or several context keys. You cannot display data from queries that have no context key assignments. A query and its query views can be seen in any application that is specified in the context key. Query View You can define several query views for one query, and a query view can belong to more queries. All queries assigned to the query view must have at least one context key in common. Query views automatically inherit the context key assignment of the query they are assigned to. If you change the assignment of the query, the context key assignment of the query views belonging to that query also change. Dashboards and Quick Views Dashboards and quick views are always assigned to one context key, and you cannot change the context key assignment of these objects. Both can contain only queries and query views that are assigned to the same context key. If you change the context key assignment of a query, the corresponding query views do not ap- pear as quick views anymore. If various applications need the same dashboard, it must be defined individually for each applica- tion with the context key of each application assigned to it. Context Keys can only be defined in Customizing, navigated to through the following path: Cross-Application Components → Processes and Tools for Enterprise Applications → Business Context Viewer→ Foundation, Monitoring → Define Context Key. Search Connector You define the business scenario where you want to use BCV by defining search connectors. You specify the kind of business analytics you want to perform using BCV. Your business requirements define the data providers and data provision technology that you must use. Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 309
318.
7/26/2020 SAP e-book 1/1 Figure
158: Search Connector A search connector establishes the connection between the data provision technology and the BCV by providing search access to a specific data provider at a specific destination (logical system) or list of destinations. The definition of the search connector includes the description of the selection attributes and the structure of the result data. The search connector delivers result data in a predefined form for the specified selection attributes. Table 4: Search Connectors The following types of search connectors are available depending on the type of data provision technology: Search Connector Data Provision Technology Data Provider BI search connector SAP NetWeaver Business In- telligence BI Query ES search connector Embedded Search Search template, search con- nector, search query SES search connector SAP Netweaver Business In- telligence Business object IS search connector InfoSet search InfoSet WF search connector Workflow Workflow object type BAPI search connector Business Application Pro- gramming Interface (BAPI) Local ABAP OO class WS search connector Web service Local ABAP OO Class Unit 10: Reports © Copyright. All rights reserved. 310
319.
7/26/2020 SAP e-book 1/1 Hint: How
up to date your data is depends on the search connector you are using. Data from the BAPI and WS search connectors is always current but you must update data from ES, SES, and BI search connectors at regular intervals. Tools for this are available in the corresponding applications. The cache also has an impact on how up to date your data is. If the data is already cached, the system takes the query view result from the cache if the cache is active and not yet expired. A search connector consists of input and output fields. BI, BAPI, and SES search connectors can also include a list of additional systems where the queries are executed. BCV integrates search connectors with the following business objects: ● Query Queries collect and analyze data provided by search connectors. ● Query view Query views show the result of query processing on the Web user interface. BCV has predefined search connectors to collect and deliver data of the different objects that is to be analyzed. BI Search Connector BI search connectors are based on BI queries. These can be called across different systems. You can define new BI search connectors if the following applies: ● You have defined BI queries. ● You must release the BI query to access BI queries as a data provider. ● You have configured the RFC destinations for the systems to be called. ● You have assigned the previously created RFC connection to the new logical system. ES Search Connector BCV can find cross-system application data using Enterprise Search (ES) search connectors. ES allows data from distributed systems to be connected and indexed. ES can determine which searches are available, either locally or across systems. For example, you can use a BCV query to search for orders from a vendor from distributed ERP systems. SES Search Connector BCV can search with search engine service (SES) search connectors within an SAP system for SAP ERP Business Objects using the TREX search engine technology. BAPI Search Connector BAPI search connectors are based on the implementation of an interface. SAP delivers the following BAPI search connectors that search across the system for data: ● Material search (/BCV/CL_SIN_BAPI_MT) ● Quality message search (/BCV/CL_SIN_BAPI_QN) ● Sales order search (/BCV/CL_SIN_BAPI_SO) Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 311
320.
7/26/2020 SAP e-book 1/1 The
system transfers the data by BAPI call from the different ERP systems. WS Search Connector BCV can find application data using Web services with standardized interfaces. You can use web services, combined with application logic, as the data provision technology. Web services are identified by the following properties: ● Available in standalone mode. ● Available as application functions. ● Can be used using the Simple Object Access Protocol (SOAP) Internet standard. ● Based on Extended Markup Language (XML) and Web Services Description Language (WSDL). ● Can be searched and published. The web services that BCV supports, can be called synchronously, and extract application data using read-only access. IS Search Connector IS search connectors are based on InfoSet queries. You define the input and output fields in the InfoSet Query. The system transfers the input and output fields to the search connector and provides them as the maximum scope when defining a BCV query. As a result, when you define a BCV query, you can select individual fields from the maximum scope of the InfoSet Query fields according to your requirements. You can define the InfoSet search connectors if the following criteria apply: ● You have defined InfoSet Queries. ● You have identified the input fields of the InfoSet Query as value fields (Value Only) or as value and text fields (Text and Value). This ensures that during query execution it is visible exactly which fields need entries. SAP offers you InfoSet Queries for the following types: ● Link ● Table ● Logical Database (LDB) ● Report WF Search Connector You can use WF search connectors to search for workflow work items. You need the following data to define a WF search connector: ● Object Type The BOR object type defines the workflow that you search in (for example, BUS1178 for product workflows). ● Status Selection The status selection defines the processing status of the work item that you are searching for. Unit 10: Reports © Copyright. All rights reserved. 312
321.
7/26/2020 SAP e-book 1/1 ●
Period Selection The period selection defines the time period of the creation data of the work item. ● Workflow Steps If you select the Workflow Steps checkbox, you get a more detailed results list, that is, work items with steps. BCV Query The BCV query is a analytical tool that collects data from multiple data sources and displays the result to you in a query view. The system processes queries every time you perform one of the following actions: ● Open the side panel. ● Change the focus object in the hosting application. ● Enlarge a quick view from the side panel. ● Start a query view or dashboard from the side panel. ● Change the input data of a query view. ● Perform a drill-down on a query view. ● Test a query, query view, or dashboard. To improve system performance, the system buffers query processing. The non-initial call for the same query, input data, and user can take the result data directly from the query cache, instead of retrieving it from the data provider. You can test queries without executing them from the side panel, or the view area. You can also display statistics of BCV queries. Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 313
322.
7/26/2020 SAP e-book 1/1 Figure

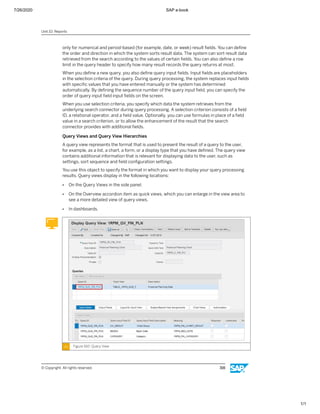

159: Query A query has the following logical structure: ● Header It contains information to identify a query (ID and description). It also contains administrative information. ● Input interface It specifies the input fields required by the query. ● Result interface It specifies the result fields provided by the query. ● Data selection description It specifies the data records that the system retrieves, and the search connector (depending on the given field values) that the system uses to retrieve them. ● Data processing description It specifies how the system fills the result fields from the retrieved data records (including grouping, aggregation, sorting). BCV has predefined queries to collect and analyze data. It integrates queries with the following business objects: ● Search connector ● Query view A query view displays the result of query processing on the user interface. Unit 10: Reports © Copyright. All rights reserved. 314
323.
7/26/2020 SAP e-book 1/1 You
can create new queries by defining a completely new query or by copying and changing an existing query. BCV has a set of predefined, standard queries. All standard query IDs begin with the number '1'. You can use these queries directly or copy them to the customer namespace by using an ID beginning with A to Z, changing them as needed. For each newly created query, you must specify a unique query ID. The system fills the header of the new query with administrative information, for example, who created the query and the time of creation. Furthermore, the system performs a consistency check of the query definition before saving it. To define a query, you must specify which objects the system selects in which data source, which fields of these objects the system returns, and how the system processes the returned data. The existence of queries is a prerequisite for the definition of query views that the system uses to display the results of query processing. During the definition of a new query, you must assign a context key to the query. If you do not assign a context key to the query, the query is not visible in BCV during runtime. You must also select an existing search connector and define its query-internal ID, and its description. The definition of a new query also requires you to define query fields. Query fields define the structure and type of the data that the system sends to and receives from the underlying search connector. On the Input Fields and Output Fields tab pages, choose Load Fields to load the input fields from the search connector automatically. You can select the required input fields from the result. The definition of a query field in Customizing consists of the following: ● You specify the field ID. ● By selecting a type, you must define whether the system uses the field in the selection criteria for input data, as a result field for output data, or both. ● By selecting the origin of the query field, you specify whether the system links the query field to a search connector. ● You specify the internal ID of the search connector that is used in the query. You can specify one or two search connectors. If the query uses two search connectors, you must also enter a query join that describes how the system should combine the search connectors. ● You enter the ID of search connector field to specify an already existing search connector field that the system links to the query field. ● You specify the data element of the query field. ● You enter the data type of the query field. The system uses this information to determine what kind of data the field can handle. ● You enter a short description of the query field. The system uses this description as a tooltip for table columns representing this field. ● You enter the short, medium, and long field labels of the query field. The system uses these field labels as a header text of table columns or as a label text of chart axes representing this field. When you define a new query you must define query result fields. Query result fields define the structure and type of the data provided by the query after query processing. You can use aggregation and grouping if you are interested in general information, while the available data provider provides information on a more detailed level. You can define aggregation functions Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 315
324.
7/26/2020 SAP e-book 1/1 only
for numerical and period-based (for example, date, or week) result fields. You can define the order and direction in which the system sorts result data. The system can sort result data retrieved from the search according to the values of certain fields. You can also define a row limit in the query header to specify how many result records the query returns at most. When you define a new query, you also define query input fields. Input fields are placeholders in the selection criteria of the query. During query processing, the system replaces input fields with specific values that you have entered manually or the system has determined automatically. By defining the sequence number of the query input field, you can specify the order of query input field input fields on the screen. When you use selection criteria, you specify which data the system retrieves from the underlying search connector during query processing. A selection criterion consists of a field ID, a relational operator, and a field value. Optionally, you can use formulas in place of a field value in a search criterion, or to allow the enhancement of the result that the search connector provides with additional fields. Query Views and Query View Hierarchies A query view represents the format that is used to present the result of a query to the user, for example, as a list, a chart, a form, or a display type that you have defined. The query view contains additional information that is relevant for displaying data to the user, such as settings, sort sequence and field configuration settings. You use this object to specify the format in which you want to display your query processing results. Query views display in the following locations: ● On the Query Views in the side panel. ● On the Overview accordion item as quick views, which you can enlarge in the view area to see a more detailed view of query views. ● In dashboards. Figure 160: Query View Unit 10: Reports © Copyright. All rights reserved. 316
325.
7/26/2020 SAP e-book 1/1 Depending
on the application using BCV, you can find a set of predefined query views in your system. You can use these as they are, or as templates to create your own query views. You can use query view hierarchies that you can find on the Query Views accordion of the side panel. You can create a query view hierarchy based on the context key. Choose the Option menu of tray Hierarchical View to display the query view hierarchy on the Query Views accordion of the side panel. Chart Types in BCV BCV offers you several ways to display the data in the user interface, all of which are independent of the data source. BCV has the following presentation technologies: ● Table (ALV) BCV uses SAP List Viewer (ALV) to display tables. The system displays fields of the table where drill-down is possible as links. The table displays the data of a single BCV query. If you assign several queries to the query view that you use to display the data, you can switch between the different queries. ● Form The system displays a single entry of the result table in a form. You can navigate to other entries of the result table using buttons. The definition of the form contains the fields you want the system to display and their sequence on the screen (in one column only). You can also display pictures in the form. The system displays fields where a drill-down is possible as links. The form displays the data of a single BCV query. If you assigned several queries to the query view, you can switch between them by selecting another display ID. ● Business graphic BCV supports the following business graphic chart types: - Line chart - Column chart - Stacked column chart - Pie chart - Bubble chart - GANTT chart - A vs B chart You can specify the chart type and select the category, value, and series fields (depending on the possibilities of the selected chart type) from the query. You can display several values of the same query in one chart. The chart displays the data of a single BCV query. If you assigned several queries to the query view, you can switch between them by selecting another chart ID. You can zoom in and out of the display. You can set up scaling and zoom in the chart definition in the configuration center. You can start a drill-down at any data point in the chart. ● Xcelsius BCV supports the integration of Xcelsius dashboards. The system receives data by means of queries and hands them over to Xcelsius by Adobe Flash Island technology. You create Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 317
326.
7/26/2020 SAP e-book 1/1 the
Xcelsius dashboards with Xcelsius designer, convert them into a flash file, and buffer them in the MIME repository. The standard navigation functions of BCV (for example, drill- down, printing, personalization) are not supported in this display. Figure 161: Chart Type If the presentation technologies are not enough for your analytical needs, you can implement your own, application-specific new presentation technology. BCV offers a Web Dynpro interface which supports the integration of application-specific presentation technologies into BCV. Dashboard The dashboard displays several query views to visualize a situation or a problem. The BCV dashboard allows you to freely organize query views in a way that best suits your analytic needs. However, the CHIPs representing the query views cannot overlap. The layout provided by Page Builder assumes a rectangular grid, which you can freely divide in columns and rows. Note: A CHIP (Collaborative Human Interface Part) is an encapsulated piece of software used to provide functions in collaboration with other CHIPs in a Page Builder page or side panel. All available CHIPs are registered in a library (CHIP catalog). The CHIP model describes capabilities of a CHIP (such as wiring) and is not based on a specific UI technology. Technically, CHIPs are Web Dynpro ABAP components that implement a certain WD Component Interface. In the case of Xcelsius dashboards, you must place no more than three flash players in a single BCV dashboard at the same time. You can use the BCV dashboard to synchronize the query views. To do this, choose Sync. The system broadcasts changes that you make to the sorter or filter in one query view to all other query views in the dashboard. If the query views contain data, such as fields with the same Unit 10: Reports © Copyright. All rights reserved. 318
327.
7/26/2020 SAP e-book 1/1 name,
or identical meanings the system takes these settings over. You can place CHIPs that are not provided by BCV on the BCV dashboard. Figure 162: Dashboard Choose the Dashboards accordion in the side panel to access the list of dashboards available for the business object you are working with, To select a dashboard from the list, choose its name. To print the query views and snapshots contained in the dashboard, choose the print function. Meanings Meanings describe the content of a field of a search connector, query, and query view. The system uses the customer-defined meanings to link these objects together. The output fields with a specific meaning can serve as input fields for another query view with the same meaning. You can define meanings at the level of search connector, or query. You use the defined meanings at the setup of the input and output fields of the search connector. When you set up the fields of a query, the meanings of the fields of the search connector assigned to the query are taken over by the system. You can overwrite the meanings if necessary. The system also uses meanings to create branches of drill-downs. The query displayed on the user interface offers a set of meanings in its query output table. All possible drill-downs that use these meanings as input are available based on these meanings. Overviews The overview is a list of query views displayed in the side panel. You can define different overviews depending on the context key. If the context key in the application changes (for example, you select a new business object), and if the side panel is not locked, the system automatically refreshes the content of the query views in the Overview accordion item. Launchpads The side panel contains accordion items that the system uses to display BCV objects, as quick views, query views, dashboards, and so on. The Launchpad accordion item contains a hierarchical tree of launchpad applications that you can use to start the application in a new session, based on the context key of BCV. Drill-Down Drill-down means the execution of consecutive queries views, or the same query view, based on the context. You use this function to refine the data the system displays to get a more detailed view during analysis. You can perform a drill-down in BCV if one of the following conditions applies: Lesson: Configuring Business Context Viewer (BCV) Content © Copyright. All rights reserved. 319
328.
7/26/2020 SAP e-book 1/1 ●
You have enlarged a quick view from the side panel, or executed a query view from the query view hierarchy. ● The queries whose query views you want to drill-down into have a meaning assigned to them. Drill-Down Features ● When you choose an existing link (may also be a point or bar in a chart), and the corresponding field has a meaning assigned to it, then the system displays a list of available navigation targets. ● The system retrieves the relevant navigation targets (query views, launchpad applications) according to the set of meanings, which consists of the meanings available up to the time of the drill-down, and the meanings transferred with the drill-down. For the first drill-down the navigation targets represent the context transferred by the application using BCV, along with the chosen meaning. A valid navigation target has at least each of the transferred meanings as selection parameter. ● If you select one of the navigation targets the system displays in a dialog box, then the system calls the target with the transferred set of meanings and its actual content. If more input fields are necessary than provided by the transfer, the system tries to retrieve these fields from previous drill-down steps. If this is not enough, the system displays a dialog box, asking you to fill in the mandatory input fields. Query Views ● The output fields of the underlying query can serve as post selection filters. To achieve this, you must define an appropriate query input field, and link it to the search connector output field by means of a selection criteria. ● The system adds a breadcrumb in the header for navigation and orientation. Additionally, the system provides a hierarchy of query view drill-downs executed so far, in the Drill- Downs accordion item of the side panel. Personalization The system memorizes nearly every change you make in BCV as personalized settings. These changes include, reorganizing dashboards, changing table and chart settings in query views, and so on. In query views, the system administrator can specify if the system should save the settings as personalized or not. LESSON SUMMARY You should now be able to: ● Configure BCV content Unit 10: Reports © Copyright. All rights reserved. 320
329.
7/26/2020 SAP e-book 1/1 Unit
10 Learning Assessment 1. Which status icon is determined from the resource planning of a portfolio item? Choose the correct answer. X A Budget Status X B Schedule Status X C Staffing Status 2. You can define dashboard fields per dashboard type. Determine whether this statement is true or false. X True X False 3. Which of the following does the side panel of a reporting cockpit contain? Choose the correct answers. X A Overview graphics X B Queries X C Query views X D Control view X E Dashboards 4. Business Context Viewer separates its configuration from the graphical representation in the front-end application. Determine whether this statement is true or false. X True X False © Copyright. All rights reserved. 321
330.
7/26/2020 SAP e-book 1/1 Unit
10 Learning Assessment - Answers 1. Which status icon is determined from the resource planning of a portfolio item? Choose the correct answer. X A Budget Status X B Schedule Status X C Staffing Status Correct. The status icon Staffing Status is determined from the resource planning of a portfolio item. 2. You can define dashboard fields per dashboard type. Determine whether this statement is true or false. X True X False Correct. You can define dashboard fields per dashboard type. 3. Which of the following does the side panel of a reporting cockpit contain? Choose the correct answers. X A Overview graphics X B Queries X C Query views X D Control view X E Dashboards Correct. The side panel contains overview graphics, query views, and dashboards. © Copyright. All rights reserved. 322
331.
7/26/2020 SAP e-book 1/1 4.
Business Context Viewer separates its configuration from the graphical representation in the front-end application. Determine whether this statement is true or false. X True X False Correct. Business Context Viewer separates its configuration from the graphical representation in the front-end application. Unit 10: Learning Assessment - Answers © Copyright. All rights reserved. 323
Download
