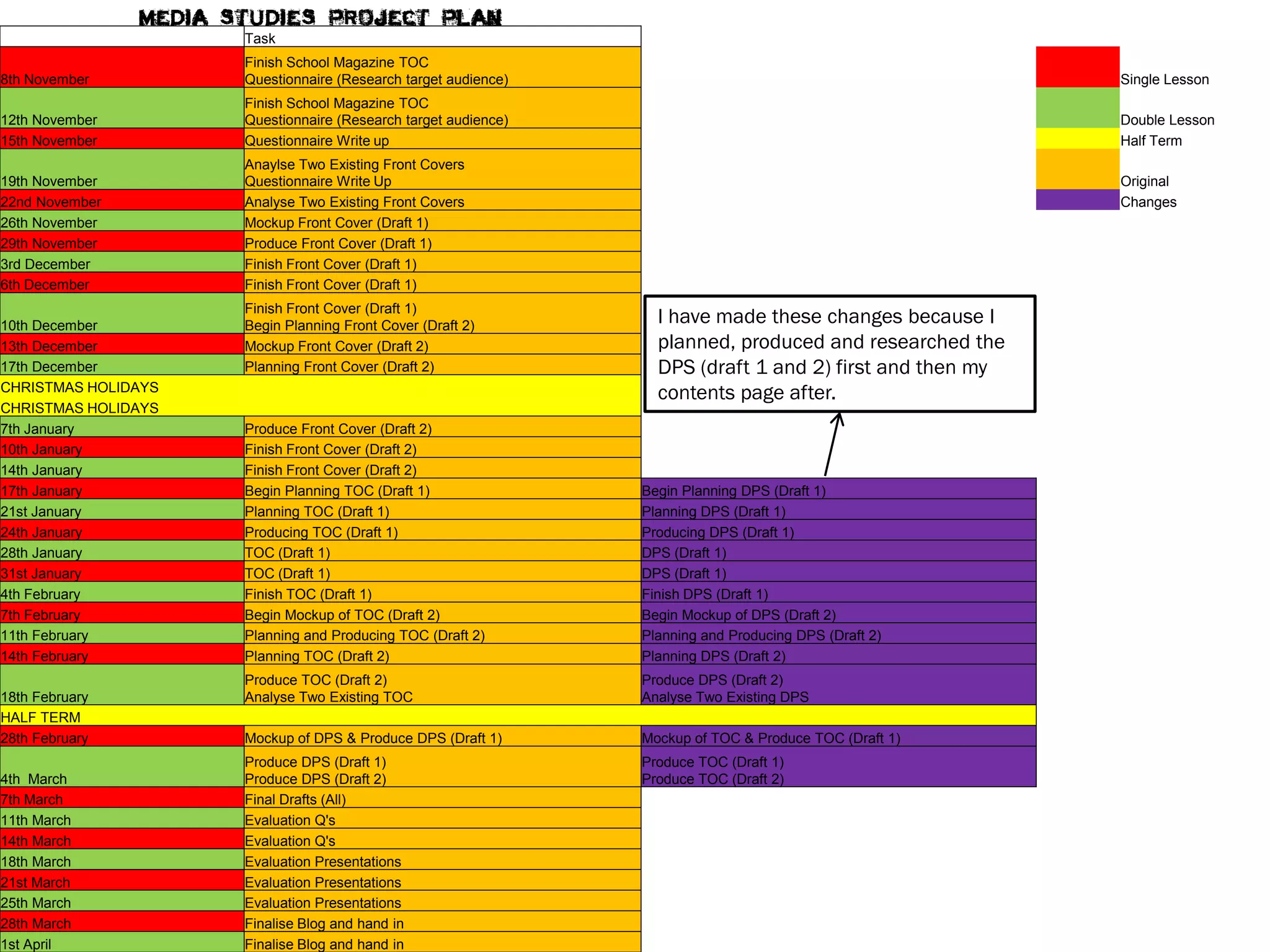

Task
                     Finish School Magazine TOC
8th November         Questionnaire (Research target audience)                                             Single Lesson
                     Finish School Magazine TOC
12th November        Questionnaire (Research target audience)                                             Double Lesson
15th November        Questionnaire Write up                                                               Half Term
                     Anaylse Two Existing Front Covers
19th November        Questionnaire Write Up                                                               Original
22nd November        Analyse Two Existing Front Covers                                                    Changes
26th November        Mockup Front Cover (Draft 1)
29th November        Produce Front Cover (Draft 1)
3rd December         Finish Front Cover (Draft 1)
6th December         Finish Front Cover (Draft 1)
                     Finish Front Cover (Draft 1)
10th December        Begin Planning Front Cover (Draft 2)
                                                                  I have made these changes because I
13th December        Mockup Front Cover (Draft 2)                 planned, produced and researched the
17th December        Planning Front Cover (Draft 2)               DPS (draft 1 and 2) first and then my
CHRISTMAS HOLIDAYS                                                contents page after.
CHRISTMAS HOLIDAYS
7th January          Produce Front Cover (Draft 2)
10th January         Finish Front Cover (Draft 2)
14th January         Finish Front Cover (Draft 2)
17th January         Begin Planning TOC (Draft 1)               Begin Planning DPS (Draft 1)
21st January         Planning TOC (Draft 1)                     Planning DPS (Draft 1)
24th January         Producing TOC (Draft 1)                    Producing DPS (Draft 1)
28th January         TOC (Draft 1)                              DPS (Draft 1)
31st January         TOC (Draft 1)                              DPS (Draft 1)
4th February         Finish TOC (Draft 1)                       Finish DPS (Draft 1)
7th February         Begin Mockup of TOC (Draft 2)              Begin Mockup of DPS (Draft 2)
11th February        Planning and Producing TOC (Draft 2)       Planning and Producing DPS (Draft 2)
14th February        Planning TOC (Draft 2)                     Planning DPS (Draft 2)
                     Produce TOC (Draft 2)                      Produce DPS (Draft 2)
18th February        Analyse Two Existing TOC                   Analyse Two Existing DPS
HALF TERM
28th February        Mockup of DPS & Produce DPS (Draft 1)      Mockup of TOC & Produce TOC (Draft 1)
                     Produce DPS (Draft 1)                      Produce TOC (Draft 1)
4th March            Produce DPS (Draft 2)                      Produce TOC (Draft 2)
7th March            Final Drafts (All)
11th March           Evaluation Q's
14th March           Evaluation Q's
18th March           Evaluation Presentations
21st March           Evaluation Presentations
25th March           Evaluation Presentations
28th March           Finalise Blog and hand in
1st April            Finalise Blog and hand in

Project plan changes

  • 1.
