Prepared By,
Navneet Kumar Jha
BITS ID : 2014HT74039
PROJECT MANAGEMENT IN CONSTRUCTION
IMPROVING PROJECT PERFORMANCE
INTRODUCTION
• Objective for the presentation is to analyse the various factors in the
project management in construction which lead to success and
failure of the projects.
• Learning from projects by understanding the essential elements of
the project management (e.g. the Leadership Role of the Project
Manager, Project Planning, Risk Management) , Analysis of project
management done in various projects worldwide

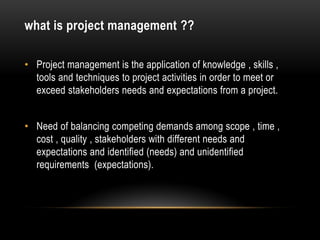

what is project management ??
• Project management is the application of knowledge , skills ,
tools and techniques to project activities in order to meet or
exceed stakeholders needs and expectations from a project.
• Need of balancing competing demands among scope , time ,
cost , quality , stakeholders with different needs and
expectations and identified (needs) and unidentified
requirements (expectations).

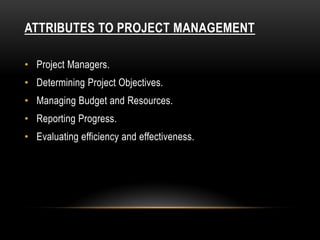

ATTRIBUTES TO PROJECT MANAGEMENT
• Project Managers.
• Determining Project Objectives.
• Managing Budget and Resources.
• Reporting Progress.
• Evaluating efficiency and effectiveness.
RESPONSIBILITIES OF PROJECT MANAGER
• Planning thoroughly through all the aspects of the project.
• Controlling the manpower of the organization.
• Optimise the technical versus cost trade offs in specific areas
where optimisation is required.
• Monitor performance , costs and efficiency of all elements of the
project.
• Completing the project on schedule and within costs .

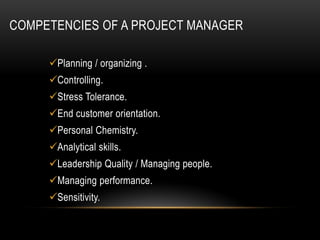

COMPETENCIES OF A PROJECT MANAGER
Planning / organizing .
Controlling.
Stress Tolerance.
End customer orientation.
Personal Chemistry.
Analytical skills.
Leadership Quality / Managing people.
Managing performance.
Sensitivity.

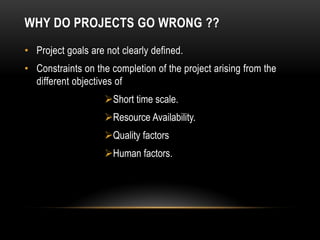

WHY DO PROJECTS GO WRONG ??
• Project goals are not clearly defined.
• Constraints on the completion of the project arising from the
different objectives of
Short time scale.
Resource Availability.
Quality factors
Human factors.
CONSTRAINTS OF PROJECT MANAGEMENT
• Cost
• Scope
• Quality
• Customer satisfaction.
• Time.
• Risk
• Resources.
PROJECT MANAGEMENT PROCESS
• Project Initiation.
• Project planning.
• Project scheduling and execution.
• Monitoring and control.
• Close Out of the project.
SUCCESSFUL PROJECTS CASE STUDIES
• AL WAHDA MASTER DEVELOPMENT , ABU DHABI.
 Vibrant bussiness and shopping destination.
 EC Harris International Ltd. Was involved in every element
from master planning of development to the concept
development and upto realization stage.
• Objectives of EC Harris international Limited.
 Project Management gateway approach. (Design verification
checks ,value engineering , Risk Management).
Categorise roles , responsibilities , communication protocols.
RESOURCES
• Truly International Project Team.
• Dynamic Team who were happy to multi task in their daily roles.
• Proper Risk Management team.
• Proper co-ordination among the team.
CHALLENGES
• Due to economic slowdown in 2008 , steel and cement prices
rocketed and whose availability was un predictable. Proper early
planning let the supply lines continue.
AQUEDUCTS AND LARGE DIAMETER TRUNK MAINS
CLEAN & MAINTAIN PROGRAMME, UNITED UTILITIES
• OBJECTIVES :
 Plan , design , develop and implement a major programme of
inspection , maintenance and repairs on two main aqueducts.
Clean and refurbish six large diameter trunk mains reducing
levels of iron and Manganese.
• RESOURCES :
Huge exercise in logistics , resource health and safety planning.
Project centric team members.
Governance board was established to review the project status
and risks.

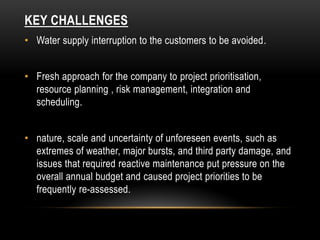

KEY CHALLENGES
• Water supply interruption to the customers to be avoided.
• Fresh approach for the company to project prioritisation,
resource planning , risk management, integration and
scheduling.
• nature, scale and uncertainty of unforeseen events, such as
extremes of weather, major bursts, and third party damage, and
issues that required reactive maintenance put pressure on the
overall annual budget and caused project priorities to be
frequently re-assessed.

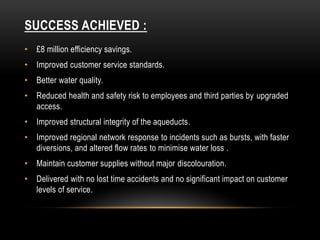

SUCCESS ACHIEVED :
• £8 million efficiency savings.
• Improved customer service standards.
• Better water quality.
• Reduced health and safety risk to employees and third parties by upgraded
access.
• Improved structural integrity of the aqueducts.
• Improved regional network response to incidents such as bursts, with faster
diversions, and altered flow rates to minimise water loss .
• Maintain customer supplies without major discolouration.
• Delivered with no lost time accidents and no significant impact on customer
levels of service.
BUILDING BETTER COMMUNITIES: MANAGING

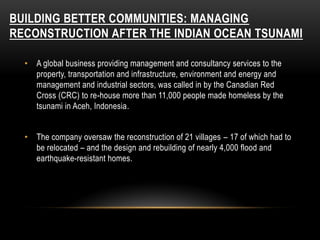

RECONSTRUCTION AFTER THE INDIAN OCEAN TSUNAMI
• A global business providing management and consultancy services to the
property, transportation and infrastructure, environment and energy and
management and industrial sectors, was called in by the Canadian Red
Cross (CRC) to re-house more than 11,000 people made homeless by the
tsunami in Aceh, Indonesia.
• The company oversaw the reconstruction of 21 villages – 17 of which had to
be relocated – and the design and rebuilding of nearly 4,000 flood and
earthquake-resistant homes.
CHALLENGES:
• According to WSP the pressure to build, in the numbers covered
by the project, in a variety of remote locations with many
unknowns, coupled with a need to complete urgently, was ‘a
challenge of a lifetime’.
• When the company arrived in Aceh in mid- 2006, it found all
contracts behind schedule, confused objectives and programmes .
• No project management unit, poor availability of materials, difficult
access because of flooding, damaged roads and bridges.
• Disaffected communities who refused to take part in planning
because previous promises had been broken.

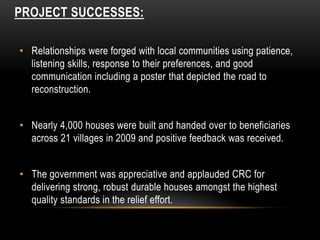

PROJECT SUCCESSES:
• Relationships were forged with local communities using patience,
listening skills, response to their preferences, and good
communication including a poster that depicted the road to
reconstruction.
• Nearly 4,000 houses were built and handed over to beneficiaries
across 21 villages in 2009 and positive feedback was received.
• The government was appreciative and applauded CRC for
delivering strong, robust durable houses amongst the highest
quality standards in the relief effort.
• WSP continued to maintain a presence for a year to ensure that,
at least for some time after the houses had been handed over,
professional and management capacity was available to iron out
issues.
• Build understanding and capacity about quality and safety from
future hazards.

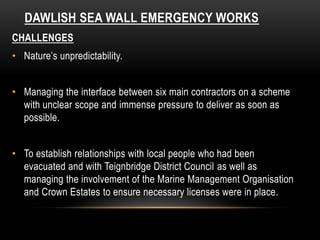

DAWLISH SEA WALL EMERGENCY WORKS
CHALLENGES
• Nature’s unpredictability.
• Managing the interface between six main contractors on a scheme
with unclear scope and immense pressure to deliver as soon as
possible.
• To establish relationships with local people who had been
evacuated and with Teignbridge District Council as well as
managing the involvement of the Marine Management Organisation
and Crown Estates to ensure necessary licenses were in place.

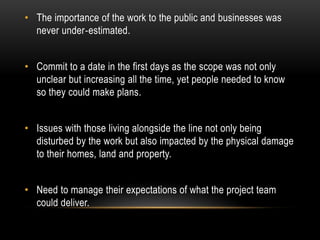

• The importance of the work to the public and businesses was
never under‐estimated.
• Commit to a date in the first days as the scope was not only
unclear but increasing all the time, yet people needed to know
so they could make plans.
• Issues with those living alongside the line not only being
disturbed by the work but also impacted by the physical damage
to their homes, land and property.
• Need to manage their expectations of what the project team
could deliver.
SUCCESS ACHIEVED
• The rail link to South and West Devon and Cornwall re‐ opened on
time to an extremely ambitious programme, allowing Dawlish and
beyond to be reconnected to their railway and the rest of the UK.
• The team received good feedback from local councils and the public,
including letters and cards of thanks from local residents. For the
project team, the immediate success of achieving the goal has also
led to long term networking and relationships, leading to opportunities
for collaboration on future projects.
• Prime Minister David Cameron, praised the ‘orange army’ of engineers
as they have become known, for their “herculean effort” in completing
the repairs.

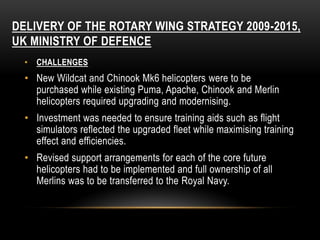

DELIVERY OF THE ROTARY WING STRATEGY 2009-2015,
UK MINISTRY OF DEFENCE
• CHALLENGES
• New Wildcat and Chinook Mk6 helicopters were to be
purchased while existing Puma, Apache, Chinook and Merlin
helicopters required upgrading and modernising.
• Investment was needed to ensure training aids such as flight
simulators reflected the upgraded fleet while maximising training
effect and efficiencies.
• Revised support arrangements for each of the core future
helicopters had to be implemented and full ownership of all
Merlins was to be transferred to the Royal Navy.

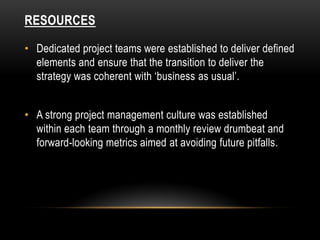

RESOURCES
• Dedicated project teams were established to deliver defined
elements and ensure that the transition to deliver the
strategy was coherent with ‘business as usual’.
• A strong project management culture was established
within each team through a monthly review drumbeat and
forward-looking metrics aimed at avoiding future pitfalls.
RESULTS
• Through the programme approach, five potent new helicopter
capabilities have been delivered to the UK’s armed forces within
the approved time and cost, while making substantial savings in
supporting military equipment.
• The £1 billion funding gap has been closed and £440 million has
been saved from the forecast cost of supporting the fleet for the
next five years without impacting upon military effectiveness.

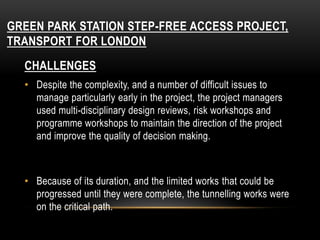

GREEN PARK STATION STEP-FREE ACCESS PROJECT,
TRANSPORT FOR LONDON
CHALLENGES
• Despite the complexity, and a number of difficult issues to
manage particularly early in the project, the project managers
used multi-disciplinary design reviews, risk workshops and
programme workshops to maintain the direction of the project
and improve the quality of decision making.
• Because of its duration, and the limited works that could be
progressed until they were complete, the tunnelling works were
on the critical path.

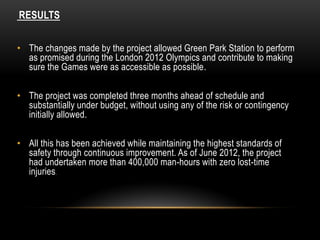

RESULTS
• The changes made by the project allowed Green Park Station to perform
as promised during the London 2012 Olympics and contribute to making
sure the Games were as accessible as possible.
• The project was completed three months ahead of schedule and
substantially under budget, without using any of the risk or contingency
initially allowed.
• All this has been achieved while maintaining the highest standards of
safety through continuous improvement. As of June 2012, the project
had undertaken more than 400,000 man-hours with zero lost-time
injuries.

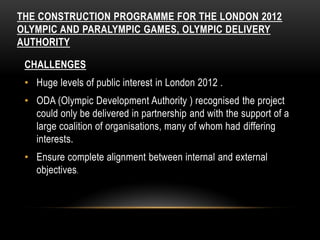

THE CONSTRUCTION PROGRAMME FOR THE LONDON 2012
OLYMPIC AND PARALYMPIC GAMES, OLYMPIC DELIVERY
AUTHORITY
CHALLENGES
• Huge levels of public interest in London 2012 .
• ODA (Olympic Development Authority ) recognised the project
could only be delivered in partnership and with the support of a
large coalition of organisations, many of whom had differing
interests.
• Ensure complete alignment between internal and external
objectives.
SUCCESS
• The ODA has successfully achieved its objectives, both for the
delivery of the physical infrastructure of the Olympic Park, and
also for significant achievements in its priority themes, such as
health and safety and sustainability.
POWERLINES UNDERGROUNDING PROJECT,
LONDON 2012
KEY OBJECTIVES OF THE PROJECT
• Deliver a quality project. , remove, mitigate and manage risk; ensure
the safety and well being of all personnel and workers engaged on or
affected by the project; demonstrate value for money; keep London
and customer supplies ‘switched on’.
SUCCESS
• Teamwork and trust were absolutely key. All parties worked as one,
focusing on the challenges in hand and buy-in to the common goal
rather than on protecting contractual positions. The fact that individual
success would only happen if everyone was successful was
understood and drove positive behaviours (there were no contractual
incentives to link these parties). Organisation and governance were
recognised as key aspects to the successful delivery of the project.
TRANSFORMING DUBLIN AIRPORT PROGRAMME,
TURNER & TOWNSEND
• CHALLENGES
• There was the sheer scale of the job of transforming Dublin Airport.
• Need to ensure that the airport stayed in full operation while work progressed – and that
key matters such as safety and passenger wellbeing are not compromised.
• Success
• Turner & Townsend successfully met the needs of the client by implementing a
programme management approach.
• Resulted in the transformation of Dublin Airport into a 21st Century Gateway to Ireland on
time and within budget.
• Stakeholder feedback on the finished product has been extremely encouraging .
WORLD’S MAJOR PROJECT FAILURE EXAMPLES
• BRITISH PETROLEUM
• Explosion cause the oil spill which was one of the worst ever oil disaster in the
history of the modern world.
• Reasons for Project Failure
• Extreme geographic location
• Weak risk management
• Lack of timely decisions
• Sluggish response in critical situation
• Undermining the situation
• Lack of planning
CASE STUDY: THE MILLENNIUM DOME
• Millennium Dome is a Dome shaped mega structure, built in the Greenwich
peninsula in south east London which was later closed because it failed to attract
the number of visitors which was expected to visit the place.
Reasons for failure
• Lack of vision.
• Poor execution.
• Lack of sufficient operational expertise.
• Poor marketing strategies.
• Financially mismanaged project.
• Lack of contingency plan.
RECOMMENDATIONS AFTER CASE STUDY:
• Management structure to be properly structured.
• Project costs
• projects should only proceed if they are clear with full life cycle
assessment cost of the project.
• Risk Analysis.
• Risk analysis of the project is necessary so that a project
manager should understand the cost which could arise in the later stages of
the project and prepare a plan for it.

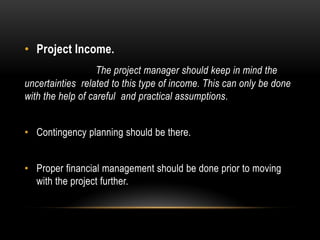

• Project Income.
The project manager should keep in mind the
uncertainties related to this type of income. This can only be done
with the help of careful and practical assumptions.
• Contingency planning should be there.
• Proper financial management should be done prior to moving
with the project further.
CONCLUSISON
• Project failure is preventable with good project planning. When a project
starts to fail there are techniques to recognize and trained Project managers
minimize the extend of project failure or recover the failed projects as early
as possible.
• Project manager needs to be trained in such techniques so that he/she not
only recover the failed projects but also reduce the chances of failure.
COLUMBIA SHUTTLE
• Columbia Shuttle Disintegrates after re-entry into the earths
atmosphere.
Lessons learnt with respect to the columbia shuttle launch
project management
• “recency effect.”
It occurs when decision makers rely on only the most recent
information.
• Conservatism
A situation in which new information is ignored or given too little weight.
• overconfidence.
During the flight, engineers, concerned that the foam strike may have
caused a problem, asked the Mission Management Team (MMT) to request
satellite imagery of the spacecraft. Management, however, was apparently
confident that there was no safety issue.
• selective perception
In which management of the shuttle program had shifted from an
engineering focus to a managerial focus.
HURRICANE KATRINA
• On August 29, 2005 hurricane Katrina raced across the Gulf of Mexico and made
landfall in New Orleans, Louisiana. When it was over, a category 5 storm had
breached the levees, flooded eighty percent of the city, killed 1,500 people, and left
over 80 billion in damages. It was the costliest natural disaster in US history.
• What followed was a project failure of enormous proportions. It failed in
planning, it failed in execution and it failed in meeting even the most basic
needs of those caught in the middle of this tragic disaster.
• Four project management failures stand out.
• Communication
• Selective Perception
• Leadership
• Difficult Relationships
LESSONS LEARNT
• We need to be careful in generalizing the project failure lessons that can be learned
from a once-in-a-hundred-year tragedy, but the magnitude of the failure was so great
that it becomes a caricature of what can go wrong in more conventional projects.
• The more constituents involved, the greater will be the communication challenge.
Unless managed effectively, far too much time can be devoted to resolving
jurisdictional conflicts and not enough time on the real issues. Too many constituents
can sabotage a project.
• Be careful of selective perception. When it goes unchecked it can be effective in
miminizing interruptions, but the consequnces of locking out new data can be
disastrous.
• Either clear leadership lines must be established, or a collaborative environment .
similar to what can emerge in high performance teams must be created and
managed.
• • Difficult relationships must be addressed. Once they surface they are unlikely to go
away.
KEY REASONS OF PROJECT FAILURE
• Lack of senior management.
• Unclear project objectives.
• Scope creep.
• Gaps in communication.
• Lack of visibility of all projects.
CONCLUSION FROM DATA COLLECTION AND DATA
ANALYSIS
• PROJECT DELAYS IN CONSTRUCTION ARE DUE TO
1. Less number of labours against requirement.
2. Skill of labour is very poor or less.
3. Lack of project planning and scheduling by contractor.
4. Delay due to receiving permissions from government authorities.
5. Delay due to transporting material from supplier to site.
6. Complete absence of good site management and supervision by contractor.
7. Lacking of quality and quantity of work.
Project management in construction

Project management in construction

  • 1.
    Prepared By, Navneet KumarJha BITS ID : 2014HT74039 PROJECT MANAGEMENT IN CONSTRUCTION IMPROVING PROJECT PERFORMANCE
  • 2.
    INTRODUCTION • Objective forthe presentation is to analyse the various factors in the project management in construction which lead to success and failure of the projects. • Learning from projects by understanding the essential elements of the project management (e.g. the Leadership Role of the Project Manager, Project Planning, Risk Management) , Analysis of project management done in various projects worldwide
  • 3.
    what is projectmanagement ?? • Project management is the application of knowledge , skills , tools and techniques to project activities in order to meet or exceed stakeholders needs and expectations from a project. • Need of balancing competing demands among scope , time , cost , quality , stakeholders with different needs and expectations and identified (needs) and unidentified requirements (expectations).
  • 4.
    ATTRIBUTES TO PROJECTMANAGEMENT • Project Managers. • Determining Project Objectives. • Managing Budget and Resources. • Reporting Progress. • Evaluating efficiency and effectiveness.
  • 5.
    RESPONSIBILITIES OF PROJECTMANAGER • Planning thoroughly through all the aspects of the project. • Controlling the manpower of the organization. • Optimise the technical versus cost trade offs in specific areas where optimisation is required. • Monitor performance , costs and efficiency of all elements of the project. • Completing the project on schedule and within costs .
  • 6.
    COMPETENCIES OF APROJECT MANAGER Planning / organizing . Controlling. Stress Tolerance. End customer orientation. Personal Chemistry. Analytical skills. Leadership Quality / Managing people. Managing performance. Sensitivity.
  • 7.
    WHY DO PROJECTSGO WRONG ?? • Project goals are not clearly defined. • Constraints on the completion of the project arising from the different objectives of Short time scale. Resource Availability. Quality factors Human factors.
  • 8.
    CONSTRAINTS OF PROJECTMANAGEMENT • Cost • Scope • Quality • Customer satisfaction. • Time. • Risk • Resources.
  • 9.
    PROJECT MANAGEMENT PROCESS •Project Initiation. • Project planning. • Project scheduling and execution. • Monitoring and control. • Close Out of the project.
  • 10.
    SUCCESSFUL PROJECTS CASESTUDIES • AL WAHDA MASTER DEVELOPMENT , ABU DHABI.  Vibrant bussiness and shopping destination.  EC Harris International Ltd. Was involved in every element from master planning of development to the concept development and upto realization stage. • Objectives of EC Harris international Limited.  Project Management gateway approach. (Design verification checks ,value engineering , Risk Management). Categorise roles , responsibilities , communication protocols.
  • 11.
    RESOURCES • Truly InternationalProject Team. • Dynamic Team who were happy to multi task in their daily roles. • Proper Risk Management team. • Proper co-ordination among the team. CHALLENGES • Due to economic slowdown in 2008 , steel and cement prices rocketed and whose availability was un predictable. Proper early planning let the supply lines continue.
  • 12.
    AQUEDUCTS AND LARGEDIAMETER TRUNK MAINS CLEAN & MAINTAIN PROGRAMME, UNITED UTILITIES • OBJECTIVES :  Plan , design , develop and implement a major programme of inspection , maintenance and repairs on two main aqueducts. Clean and refurbish six large diameter trunk mains reducing levels of iron and Manganese. • RESOURCES : Huge exercise in logistics , resource health and safety planning. Project centric team members. Governance board was established to review the project status and risks.
  • 13.
    KEY CHALLENGES • Watersupply interruption to the customers to be avoided. • Fresh approach for the company to project prioritisation, resource planning , risk management, integration and scheduling. • nature, scale and uncertainty of unforeseen events, such as extremes of weather, major bursts, and third party damage, and issues that required reactive maintenance put pressure on the overall annual budget and caused project priorities to be frequently re-assessed.
  • 14.
    SUCCESS ACHIEVED : •£8 million efficiency savings. • Improved customer service standards. • Better water quality. • Reduced health and safety risk to employees and third parties by upgraded access. • Improved structural integrity of the aqueducts. • Improved regional network response to incidents such as bursts, with faster diversions, and altered flow rates to minimise water loss . • Maintain customer supplies without major discolouration. • Delivered with no lost time accidents and no significant impact on customer levels of service.
  • 15.
    BUILDING BETTER COMMUNITIES:MANAGING RECONSTRUCTION AFTER THE INDIAN OCEAN TSUNAMI • A global business providing management and consultancy services to the property, transportation and infrastructure, environment and energy and management and industrial sectors, was called in by the Canadian Red Cross (CRC) to re-house more than 11,000 people made homeless by the tsunami in Aceh, Indonesia. • The company oversaw the reconstruction of 21 villages – 17 of which had to be relocated – and the design and rebuilding of nearly 4,000 flood and earthquake-resistant homes.
  • 16.
    CHALLENGES: • According toWSP the pressure to build, in the numbers covered by the project, in a variety of remote locations with many unknowns, coupled with a need to complete urgently, was ‘a challenge of a lifetime’. • When the company arrived in Aceh in mid- 2006, it found all contracts behind schedule, confused objectives and programmes . • No project management unit, poor availability of materials, difficult access because of flooding, damaged roads and bridges. • Disaffected communities who refused to take part in planning because previous promises had been broken.
  • 17.
    PROJECT SUCCESSES: • Relationshipswere forged with local communities using patience, listening skills, response to their preferences, and good communication including a poster that depicted the road to reconstruction. • Nearly 4,000 houses were built and handed over to beneficiaries across 21 villages in 2009 and positive feedback was received. • The government was appreciative and applauded CRC for delivering strong, robust durable houses amongst the highest quality standards in the relief effort.
  • 18.
    • WSP continuedto maintain a presence for a year to ensure that, at least for some time after the houses had been handed over, professional and management capacity was available to iron out issues. • Build understanding and capacity about quality and safety from future hazards.
  • 19.
    DAWLISH SEA WALLEMERGENCY WORKS CHALLENGES • Nature’s unpredictability. • Managing the interface between six main contractors on a scheme with unclear scope and immense pressure to deliver as soon as possible. • To establish relationships with local people who had been evacuated and with Teignbridge District Council as well as managing the involvement of the Marine Management Organisation and Crown Estates to ensure necessary licenses were in place.
  • 20.
    • The importanceof the work to the public and businesses was never under‐estimated. • Commit to a date in the first days as the scope was not only unclear but increasing all the time, yet people needed to know so they could make plans. • Issues with those living alongside the line not only being disturbed by the work but also impacted by the physical damage to their homes, land and property. • Need to manage their expectations of what the project team could deliver.
  • 21.
    SUCCESS ACHIEVED • Therail link to South and West Devon and Cornwall re‐ opened on time to an extremely ambitious programme, allowing Dawlish and beyond to be reconnected to their railway and the rest of the UK. • The team received good feedback from local councils and the public, including letters and cards of thanks from local residents. For the project team, the immediate success of achieving the goal has also led to long term networking and relationships, leading to opportunities for collaboration on future projects. • Prime Minister David Cameron, praised the ‘orange army’ of engineers as they have become known, for their “herculean effort” in completing the repairs.
  • 22.
    DELIVERY OF THEROTARY WING STRATEGY 2009-2015, UK MINISTRY OF DEFENCE • CHALLENGES • New Wildcat and Chinook Mk6 helicopters were to be purchased while existing Puma, Apache, Chinook and Merlin helicopters required upgrading and modernising. • Investment was needed to ensure training aids such as flight simulators reflected the upgraded fleet while maximising training effect and efficiencies. • Revised support arrangements for each of the core future helicopters had to be implemented and full ownership of all Merlins was to be transferred to the Royal Navy.
  • 23.
    RESOURCES • Dedicated projectteams were established to deliver defined elements and ensure that the transition to deliver the strategy was coherent with ‘business as usual’. • A strong project management culture was established within each team through a monthly review drumbeat and forward-looking metrics aimed at avoiding future pitfalls.
  • 24.
    RESULTS • Through theprogramme approach, five potent new helicopter capabilities have been delivered to the UK’s armed forces within the approved time and cost, while making substantial savings in supporting military equipment. • The £1 billion funding gap has been closed and £440 million has been saved from the forecast cost of supporting the fleet for the next five years without impacting upon military effectiveness.
  • 25.
    GREEN PARK STATIONSTEP-FREE ACCESS PROJECT, TRANSPORT FOR LONDON CHALLENGES • Despite the complexity, and a number of difficult issues to manage particularly early in the project, the project managers used multi-disciplinary design reviews, risk workshops and programme workshops to maintain the direction of the project and improve the quality of decision making. • Because of its duration, and the limited works that could be progressed until they were complete, the tunnelling works were on the critical path.
  • 26.
    RESULTS • The changesmade by the project allowed Green Park Station to perform as promised during the London 2012 Olympics and contribute to making sure the Games were as accessible as possible. • The project was completed three months ahead of schedule and substantially under budget, without using any of the risk or contingency initially allowed. • All this has been achieved while maintaining the highest standards of safety through continuous improvement. As of June 2012, the project had undertaken more than 400,000 man-hours with zero lost-time injuries.
  • 27.
    THE CONSTRUCTION PROGRAMMEFOR THE LONDON 2012 OLYMPIC AND PARALYMPIC GAMES, OLYMPIC DELIVERY AUTHORITY CHALLENGES • Huge levels of public interest in London 2012 . • ODA (Olympic Development Authority ) recognised the project could only be delivered in partnership and with the support of a large coalition of organisations, many of whom had differing interests. • Ensure complete alignment between internal and external objectives.
  • 28.
    SUCCESS • The ODAhas successfully achieved its objectives, both for the delivery of the physical infrastructure of the Olympic Park, and also for significant achievements in its priority themes, such as health and safety and sustainability.
  • 29.
    POWERLINES UNDERGROUNDING PROJECT, LONDON2012 KEY OBJECTIVES OF THE PROJECT • Deliver a quality project. , remove, mitigate and manage risk; ensure the safety and well being of all personnel and workers engaged on or affected by the project; demonstrate value for money; keep London and customer supplies ‘switched on’. SUCCESS • Teamwork and trust were absolutely key. All parties worked as one, focusing on the challenges in hand and buy-in to the common goal rather than on protecting contractual positions. The fact that individual success would only happen if everyone was successful was understood and drove positive behaviours (there were no contractual incentives to link these parties). Organisation and governance were recognised as key aspects to the successful delivery of the project.
  • 30.
    TRANSFORMING DUBLIN AIRPORTPROGRAMME, TURNER & TOWNSEND • CHALLENGES • There was the sheer scale of the job of transforming Dublin Airport. • Need to ensure that the airport stayed in full operation while work progressed – and that key matters such as safety and passenger wellbeing are not compromised. • Success • Turner & Townsend successfully met the needs of the client by implementing a programme management approach. • Resulted in the transformation of Dublin Airport into a 21st Century Gateway to Ireland on time and within budget. • Stakeholder feedback on the finished product has been extremely encouraging .
  • 31.
    WORLD’S MAJOR PROJECTFAILURE EXAMPLES • BRITISH PETROLEUM • Explosion cause the oil spill which was one of the worst ever oil disaster in the history of the modern world. • Reasons for Project Failure • Extreme geographic location • Weak risk management • Lack of timely decisions • Sluggish response in critical situation • Undermining the situation • Lack of planning
  • 32.
    CASE STUDY: THEMILLENNIUM DOME • Millennium Dome is a Dome shaped mega structure, built in the Greenwich peninsula in south east London which was later closed because it failed to attract the number of visitors which was expected to visit the place. Reasons for failure • Lack of vision. • Poor execution. • Lack of sufficient operational expertise. • Poor marketing strategies. • Financially mismanaged project. • Lack of contingency plan.
  • 33.
    RECOMMENDATIONS AFTER CASESTUDY: • Management structure to be properly structured. • Project costs • projects should only proceed if they are clear with full life cycle assessment cost of the project. • Risk Analysis. • Risk analysis of the project is necessary so that a project manager should understand the cost which could arise in the later stages of the project and prepare a plan for it.
  • 34.
    • Project Income. Theproject manager should keep in mind the uncertainties related to this type of income. This can only be done with the help of careful and practical assumptions. • Contingency planning should be there. • Proper financial management should be done prior to moving with the project further.
  • 35.
    CONCLUSISON • Project failureis preventable with good project planning. When a project starts to fail there are techniques to recognize and trained Project managers minimize the extend of project failure or recover the failed projects as early as possible. • Project manager needs to be trained in such techniques so that he/she not only recover the failed projects but also reduce the chances of failure.
  • 36.
    COLUMBIA SHUTTLE • ColumbiaShuttle Disintegrates after re-entry into the earths atmosphere. Lessons learnt with respect to the columbia shuttle launch project management • “recency effect.” It occurs when decision makers rely on only the most recent information.
  • 37.
    • Conservatism A situationin which new information is ignored or given too little weight. • overconfidence. During the flight, engineers, concerned that the foam strike may have caused a problem, asked the Mission Management Team (MMT) to request satellite imagery of the spacecraft. Management, however, was apparently confident that there was no safety issue. • selective perception In which management of the shuttle program had shifted from an engineering focus to a managerial focus.
  • 38.
    HURRICANE KATRINA • OnAugust 29, 2005 hurricane Katrina raced across the Gulf of Mexico and made landfall in New Orleans, Louisiana. When it was over, a category 5 storm had breached the levees, flooded eighty percent of the city, killed 1,500 people, and left over 80 billion in damages. It was the costliest natural disaster in US history. • What followed was a project failure of enormous proportions. It failed in planning, it failed in execution and it failed in meeting even the most basic needs of those caught in the middle of this tragic disaster.
  • 39.
    • Four projectmanagement failures stand out. • Communication • Selective Perception • Leadership • Difficult Relationships
  • 40.
    LESSONS LEARNT • Weneed to be careful in generalizing the project failure lessons that can be learned from a once-in-a-hundred-year tragedy, but the magnitude of the failure was so great that it becomes a caricature of what can go wrong in more conventional projects. • The more constituents involved, the greater will be the communication challenge. Unless managed effectively, far too much time can be devoted to resolving jurisdictional conflicts and not enough time on the real issues. Too many constituents can sabotage a project. • Be careful of selective perception. When it goes unchecked it can be effective in miminizing interruptions, but the consequnces of locking out new data can be disastrous. • Either clear leadership lines must be established, or a collaborative environment . similar to what can emerge in high performance teams must be created and managed. • • Difficult relationships must be addressed. Once they surface they are unlikely to go away.
  • 41.
    KEY REASONS OFPROJECT FAILURE • Lack of senior management. • Unclear project objectives. • Scope creep. • Gaps in communication. • Lack of visibility of all projects.
  • 42.
    CONCLUSION FROM DATACOLLECTION AND DATA ANALYSIS • PROJECT DELAYS IN CONSTRUCTION ARE DUE TO 1. Less number of labours against requirement. 2. Skill of labour is very poor or less. 3. Lack of project planning and scheduling by contractor. 4. Delay due to receiving permissions from government authorities. 5. Delay due to transporting material from supplier to site. 6. Complete absence of good site management and supervision by contractor. 7. Lacking of quality and quantity of work.
