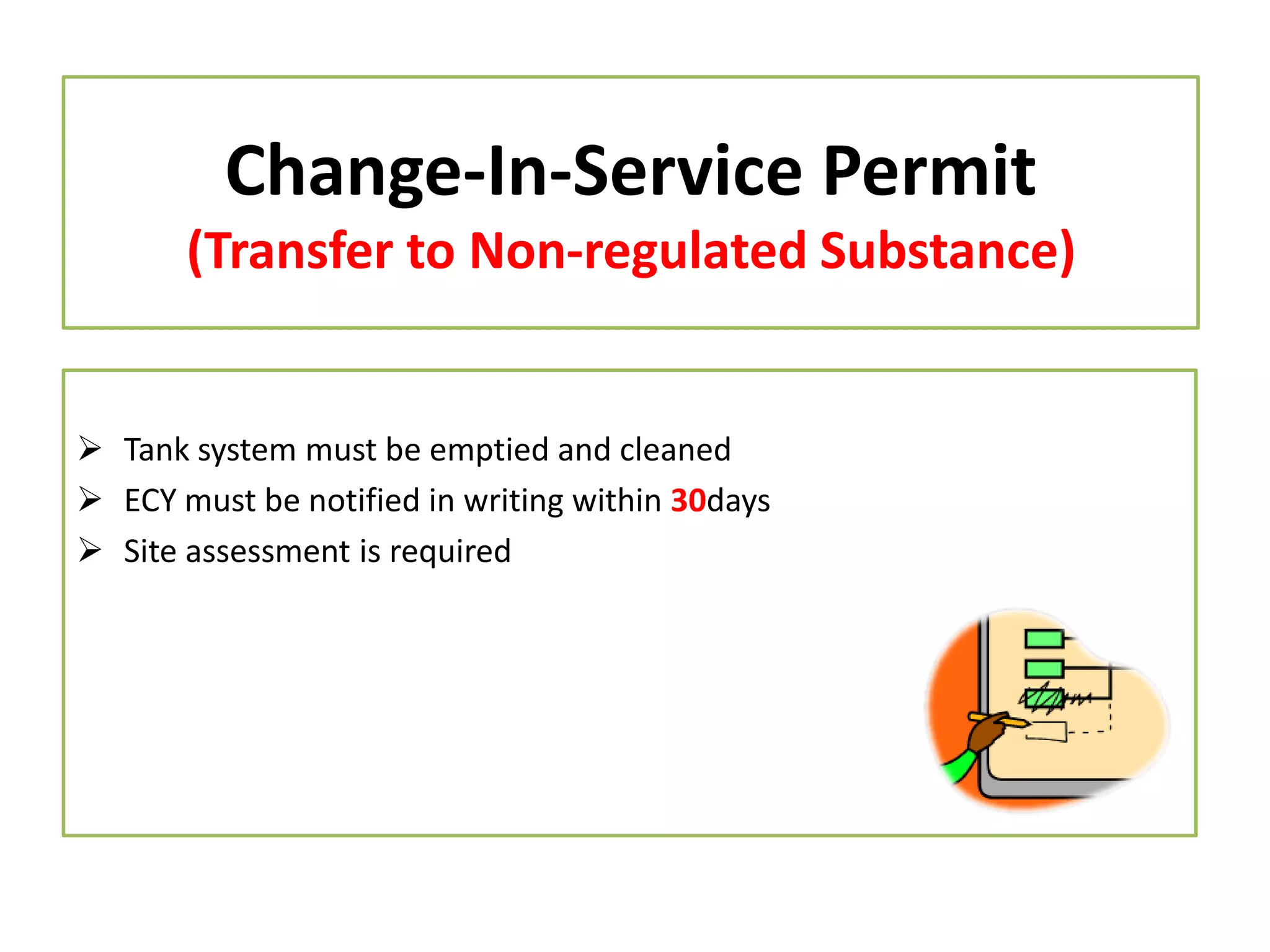

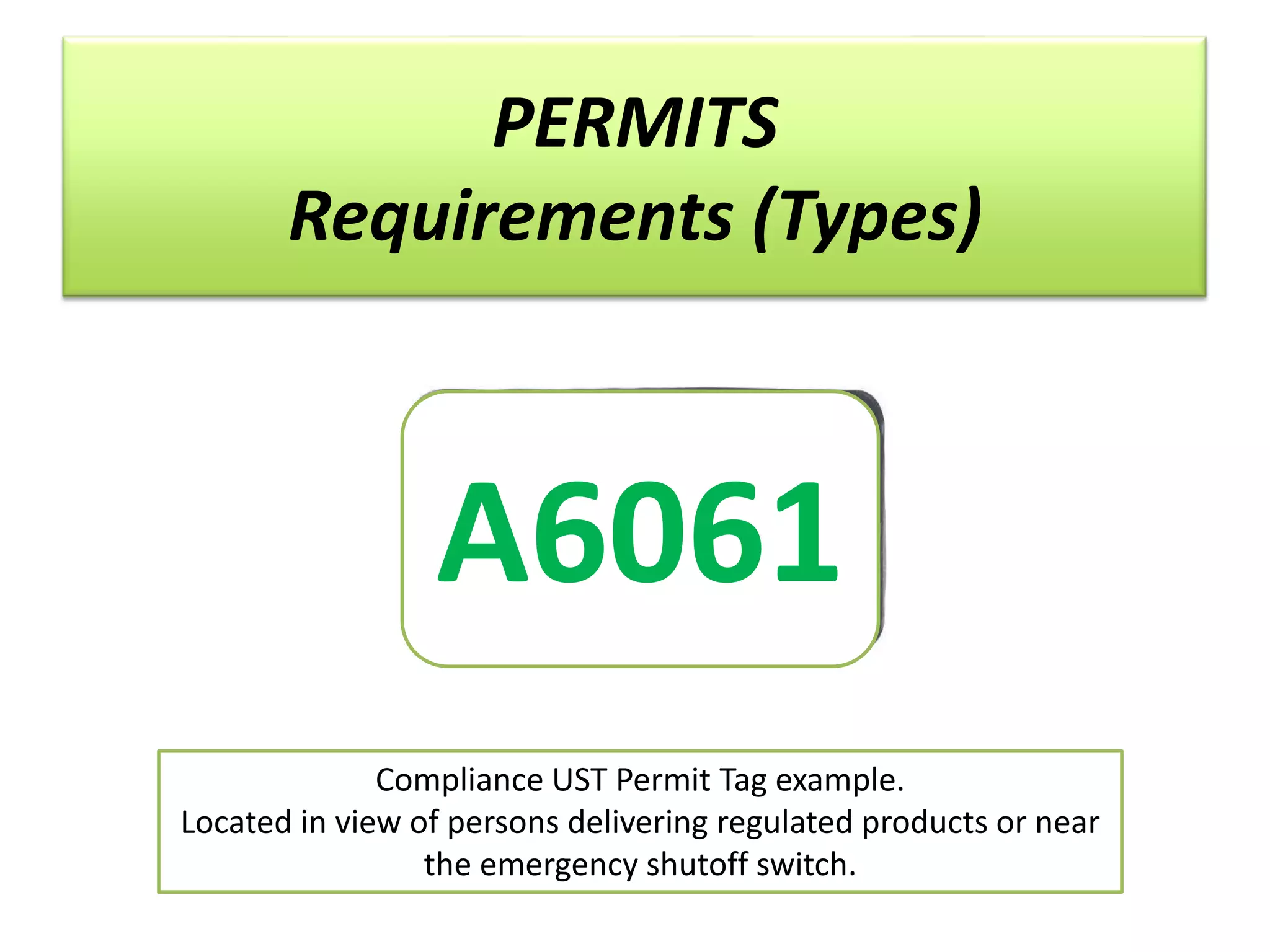

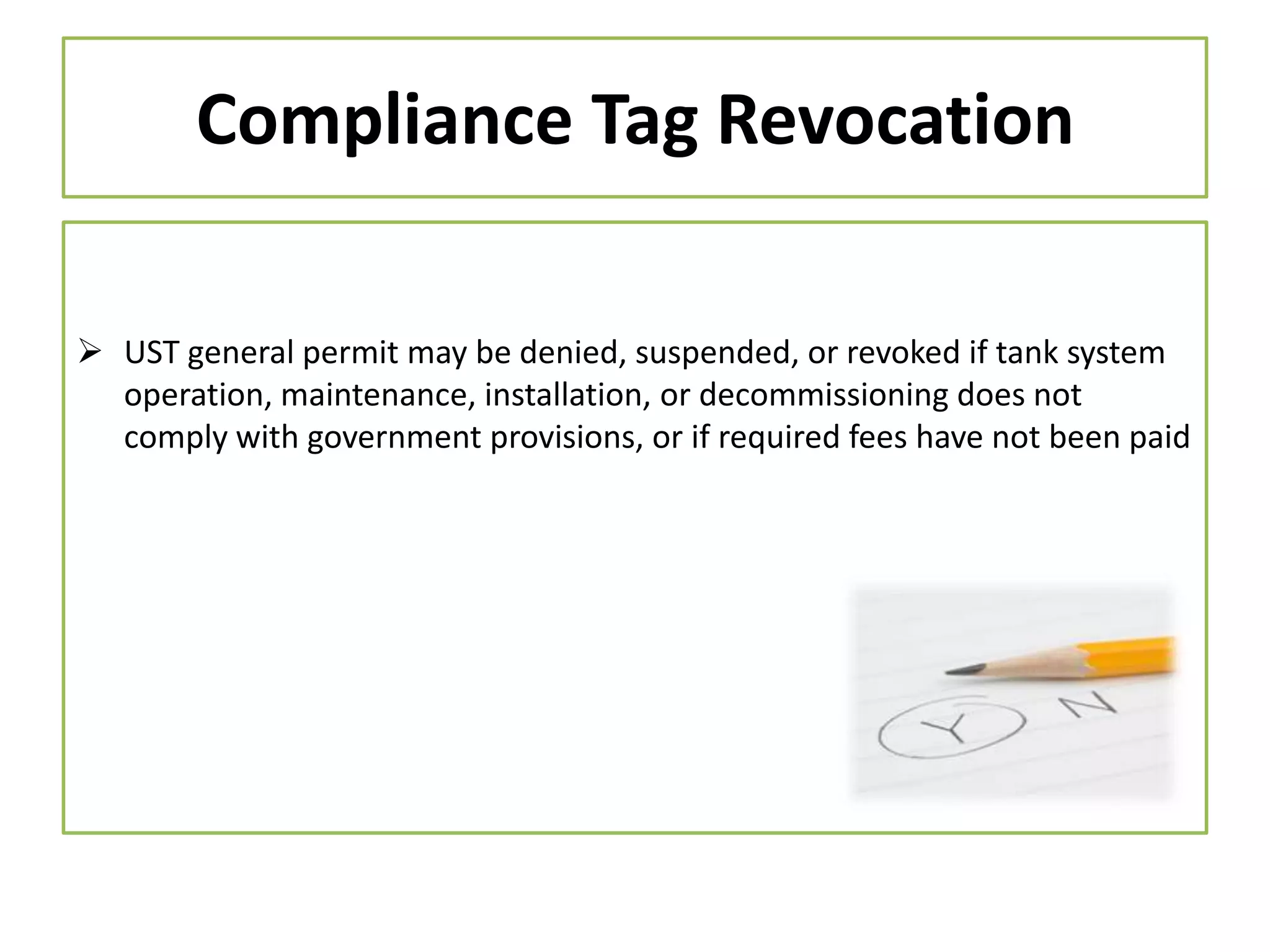

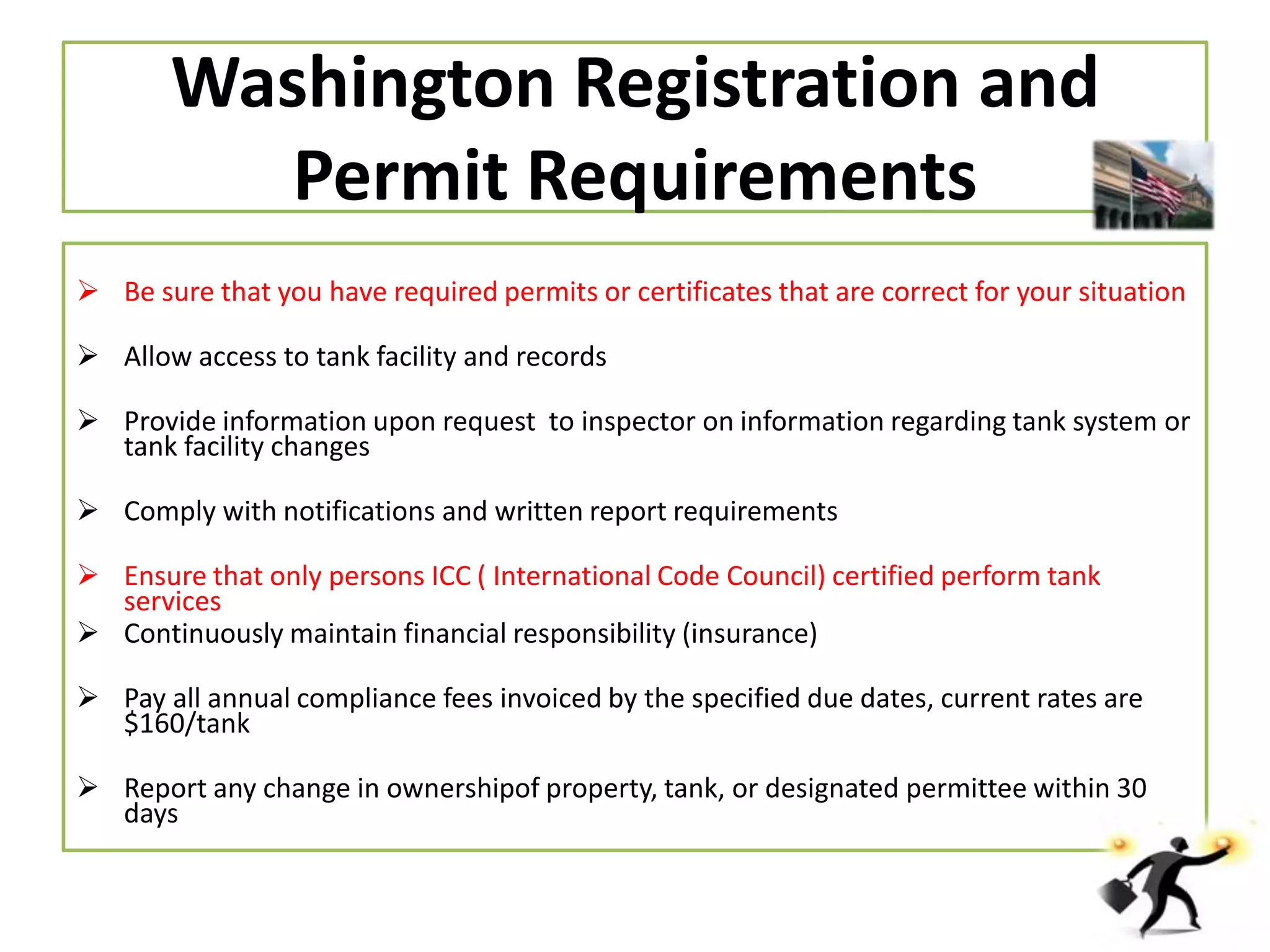

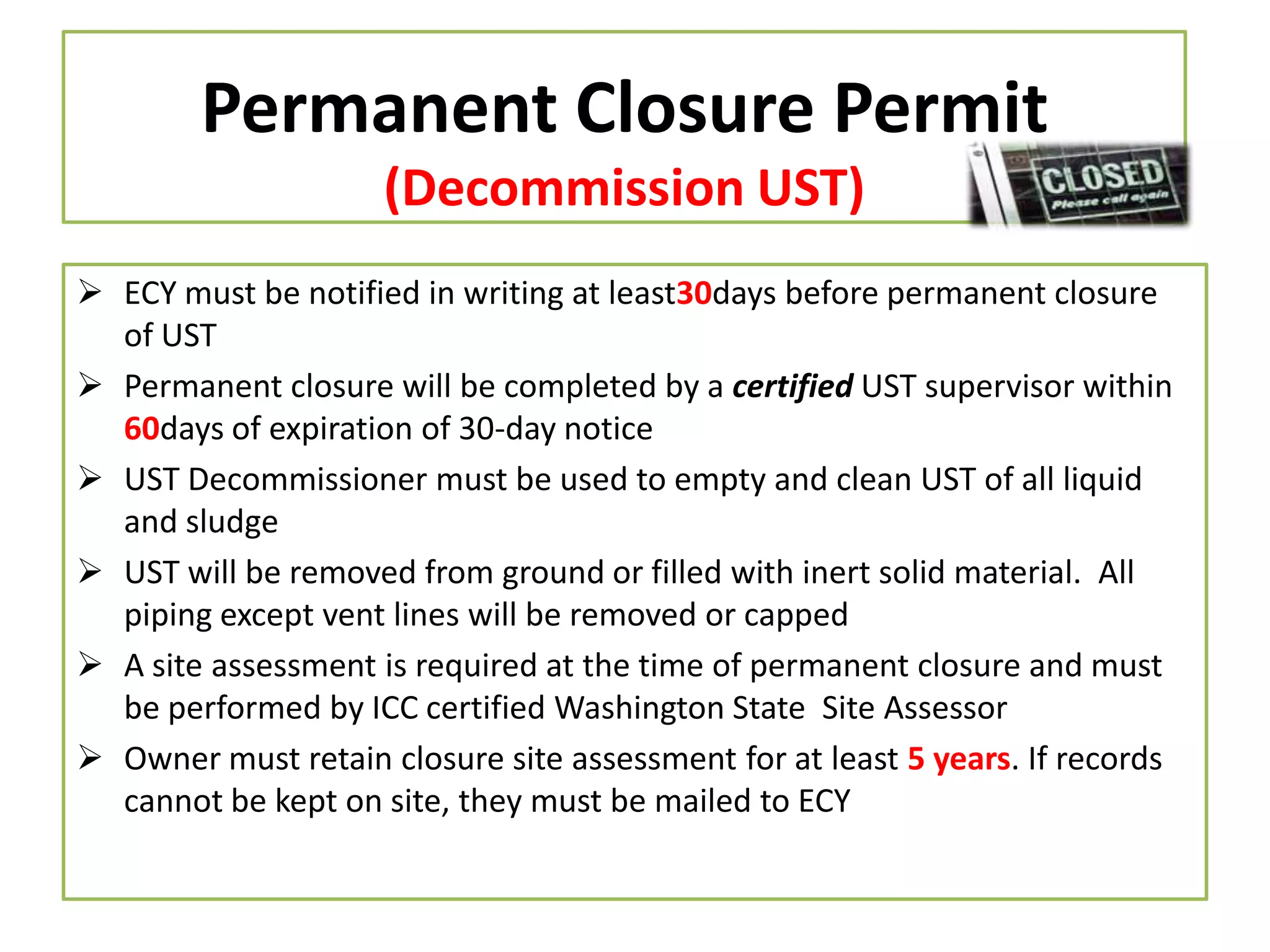

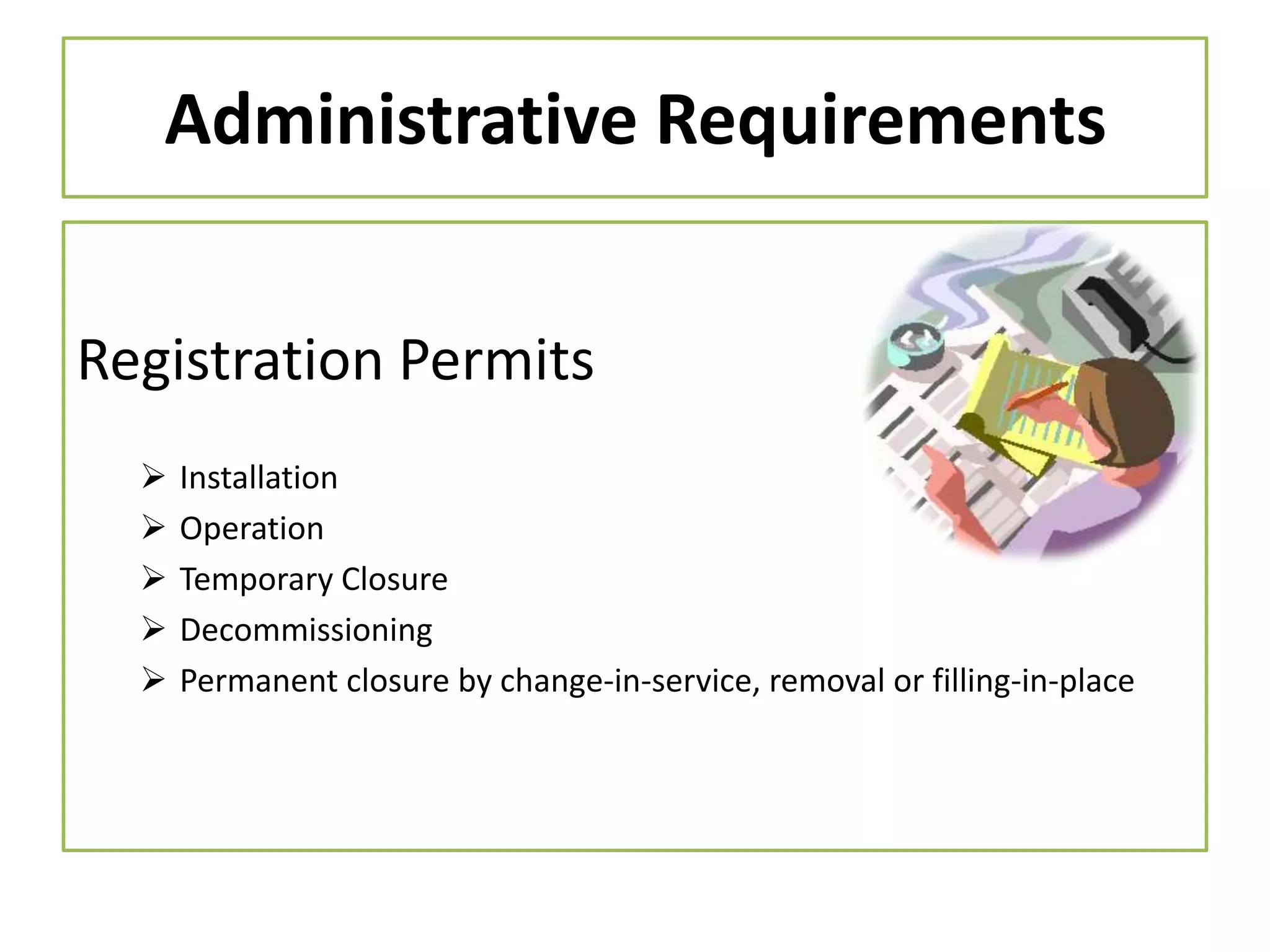

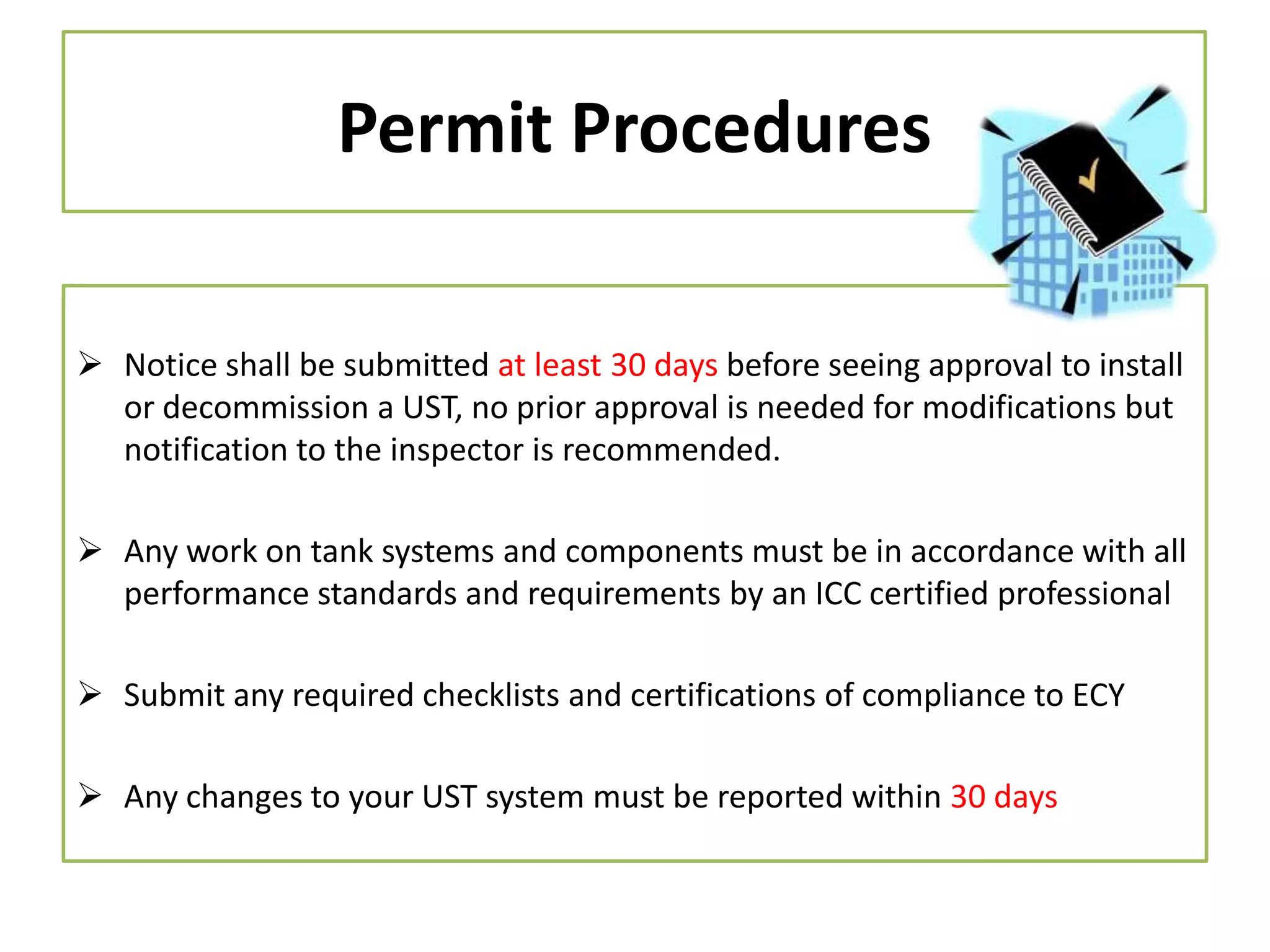

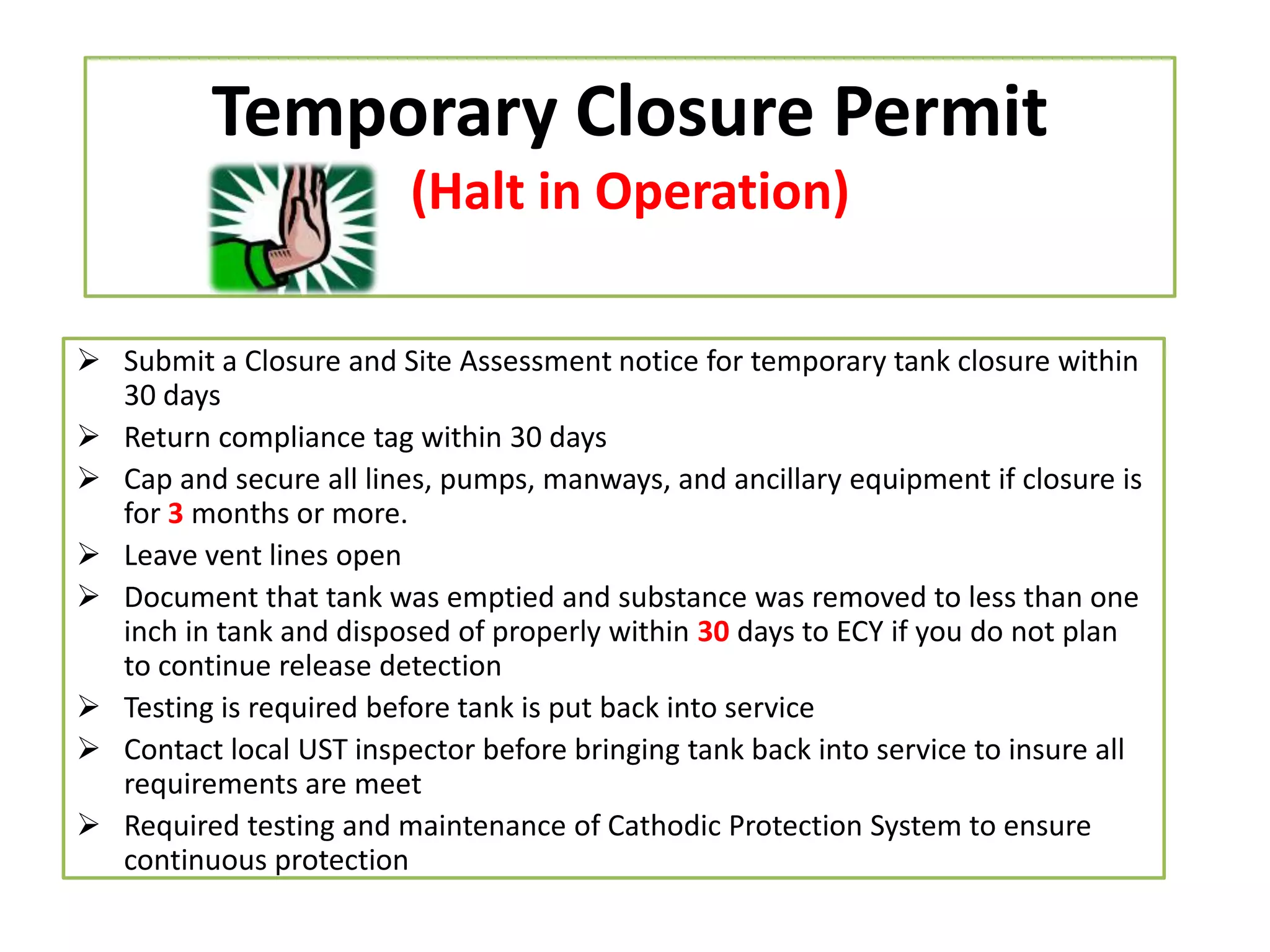

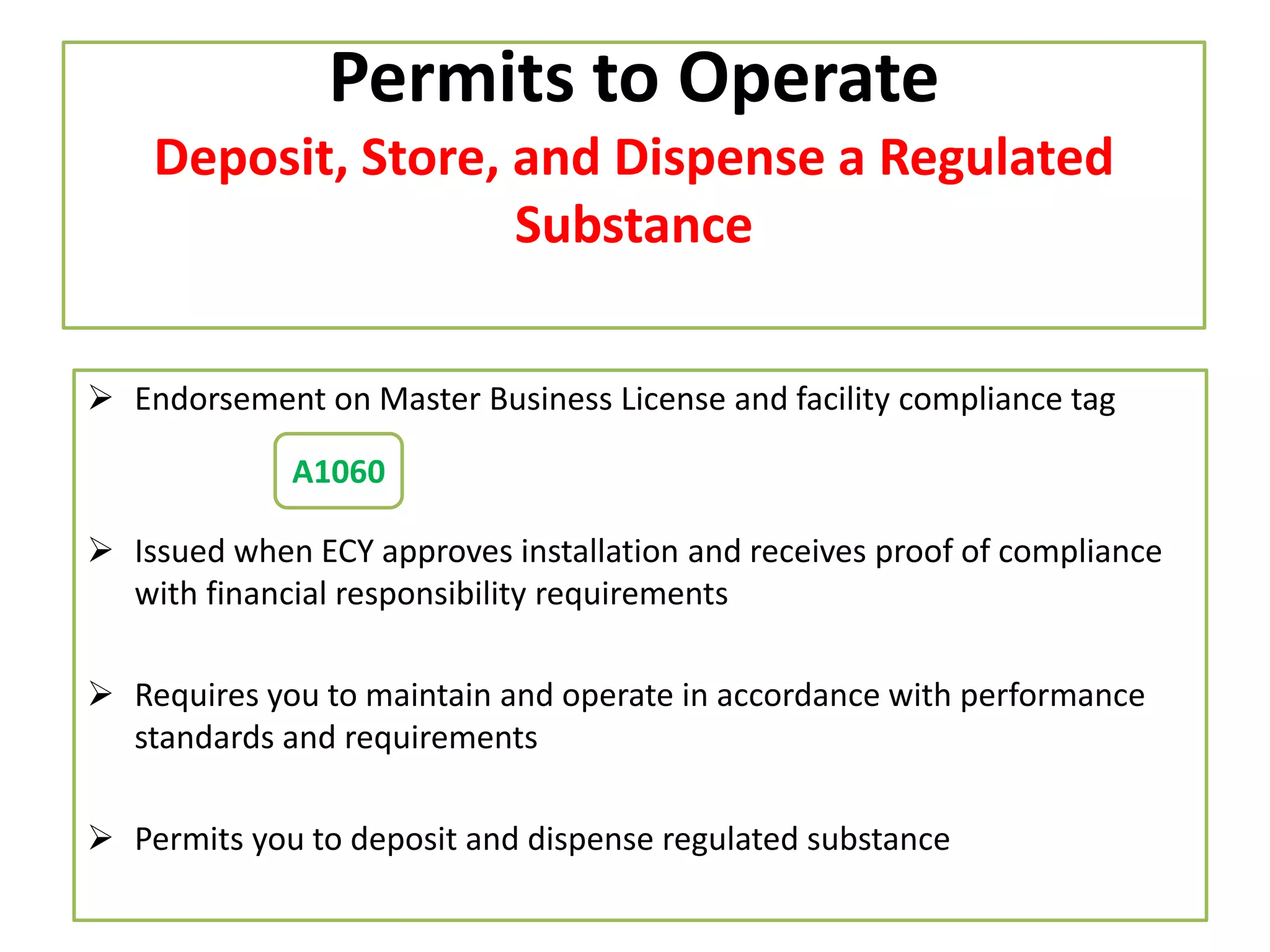

This document outlines the various permit requirements for underground storage tanks (USTs) in Washington state. It discusses the types of permits needed for installing, operating, temporarily closing, decommissioning, or permanently closing a UST through removal or filling. Notifications to the state environmental agency are required at least 30 days prior to installation, decommissioning, or certain changes. All work on UST systems must follow performance standards and be conducted by certified professionals. Permit holders must allow inspections, maintain compliance documentation and financial responsibility, report any changes or closure within 30 days, and pay annual fees. Permits can be revoked for noncompliance.
