Agile and Telco projects
        Lessons learned
so what's this about ?

 Agile management in MVNO
      project - GaduAIR

During launch - January 2008 until May 2009, and
     maintenance and development later on
who are we ?
Grzegorz Machniewski        Dawid Mielnik

• Until July 2010 Telco     • Until July 2010 Telco
  dept. @ Gadu-Gadu           dept. @ Gadu-Gadu

• Before: IBM, Outbox       • Before: Citi, DRSA

• After: Voiceware S.J.,    • After: Voiceware S.J.,
  Moberia sp. Z o.o., XEO     Moberia sp. Z o.o.
  Games sp. Z o.o.
Internet vs. Telco
     services
       typical..
software is only a small part

 • 5 teams, about 15 people

 • Software teams

    • BSS, VAS

 • Non software teams

    • Core Network, VoIP, Operations

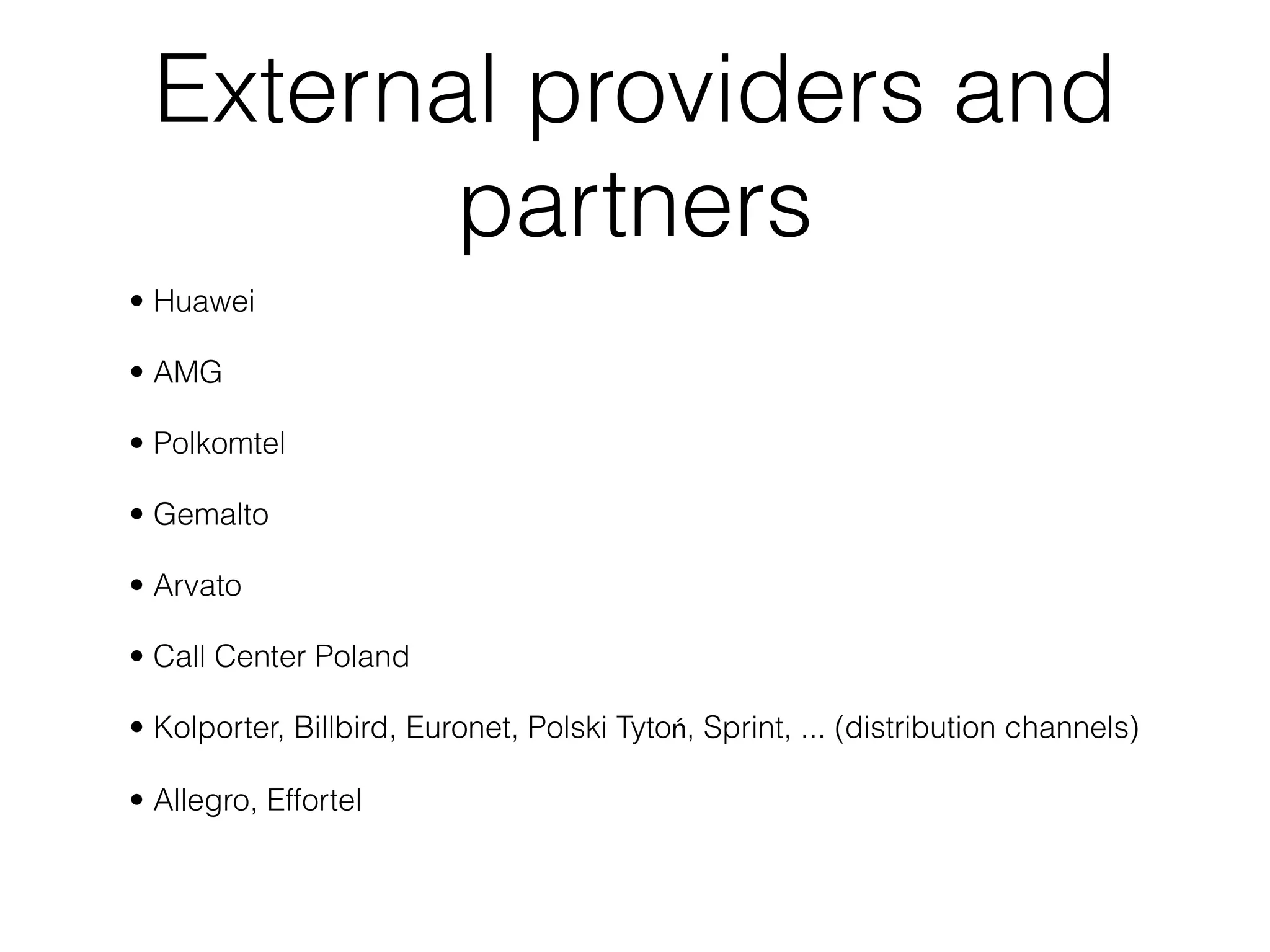

External providers and
        partners
• Huawei

• AMG

• Polkomtel

• Gemalto

• Arvato

• Call Center Poland

• Kolporter, Billbird, Euronet, Polski Tytoń, Sprint, ... (distribution channels)

• Allegro, Effortel
internal departments
• "clients"        • "providers"

    • Business         • Admins

    • Marketing        • Server dev

    • Sales            • Web dev

    • Board            • GG client dev

    • Accounting       • Mail dev

    • Security         • QA
SCRUM didn't work

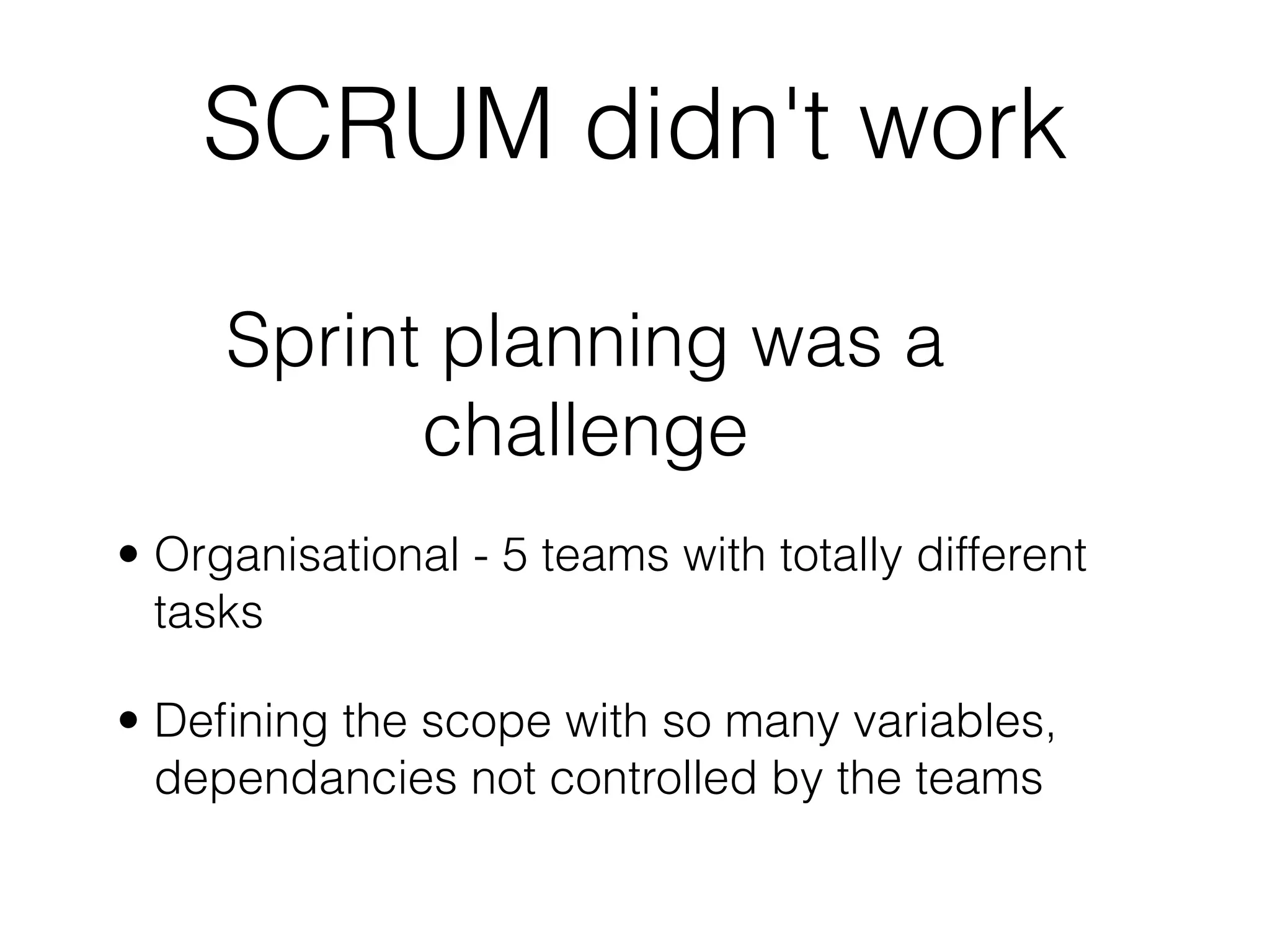

SCRUM didn't work

     Sprint planning was a
           challenge
• Organisational - 5 teams with totally different
  tasks

• Defining the scope with so many variables,
  dependancies not controlled by the teams
SCRUM didn't work

Problems with deliverables
  from external vendors
• Deadlines - frequent delays

• Functionality - does not work or works not
  according to specs, or is unstable
SCRUM didn't work

Other problems with vendors
 • Communication

 • Long time for problem resolution

 • Rotation of team members
SCRUM didn't work
Problems with schedules of internal
            providers
• Need to fit into other schedules not fully consistent with
  our

• Fight for compromises and giving higher priority to our
  tasks
SCRUM didn't work

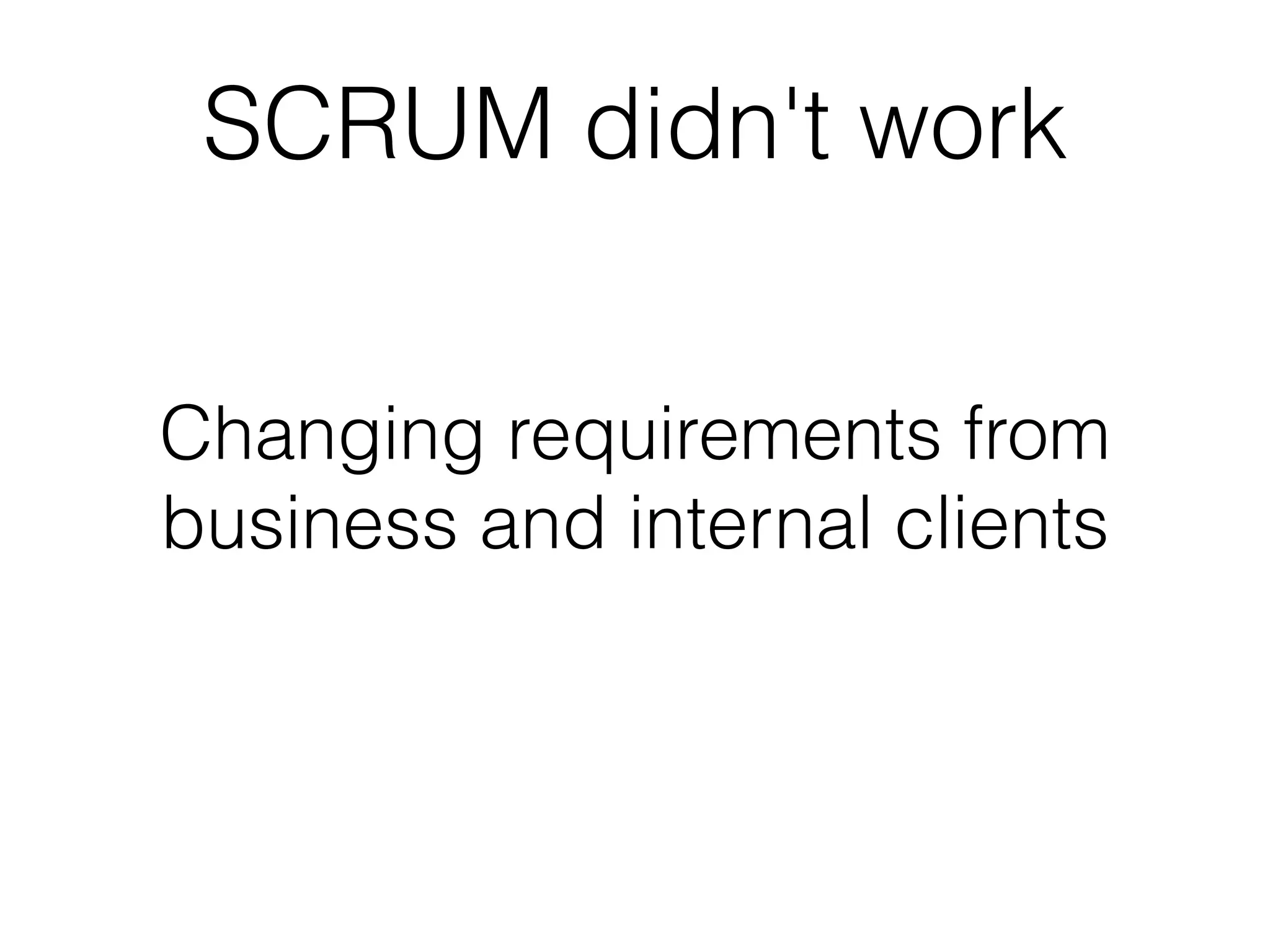

Changing requirements from
business and internal clients
SCRUM didn't work

Lot of unexpected 'fires' which
         broke sprints
SCRUM didn't work
        (additional afterthought)

  Agile methodology means
     less paperwork and
formalities which unfortunately
  works to our disadvantage
          with vendors

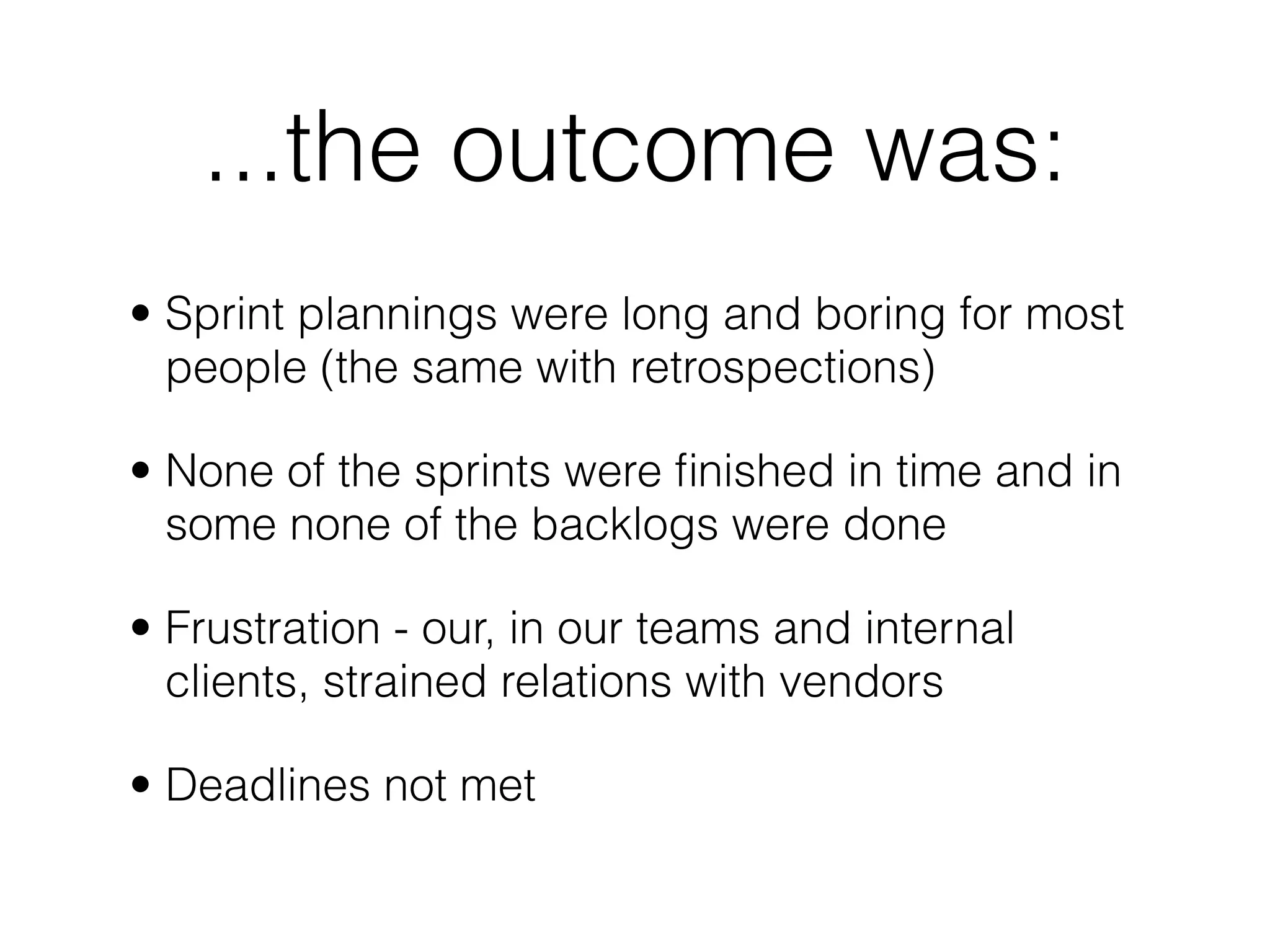

...the outcome was:
• Sprint plannings were long and boring for most
  people (the same with retrospections)

• None of the sprints were finished in time and in
  some none of the backlogs were done

• Frustration - our, in our teams and internal
  clients, strained relations with vendors

• Deadlines not met
We decided to do
  something about it...
                              Step 1
• We stopped Sprint planning in favour of quick planning in
  individual teams

• Every team had individual backlog and sprint

• We losened a little the sprint concept and everything related to it

• We started to prioritise tasks on daily bases according to what
  was more urgent

• We started to define new states for tasks which waited for
  something independent of the team

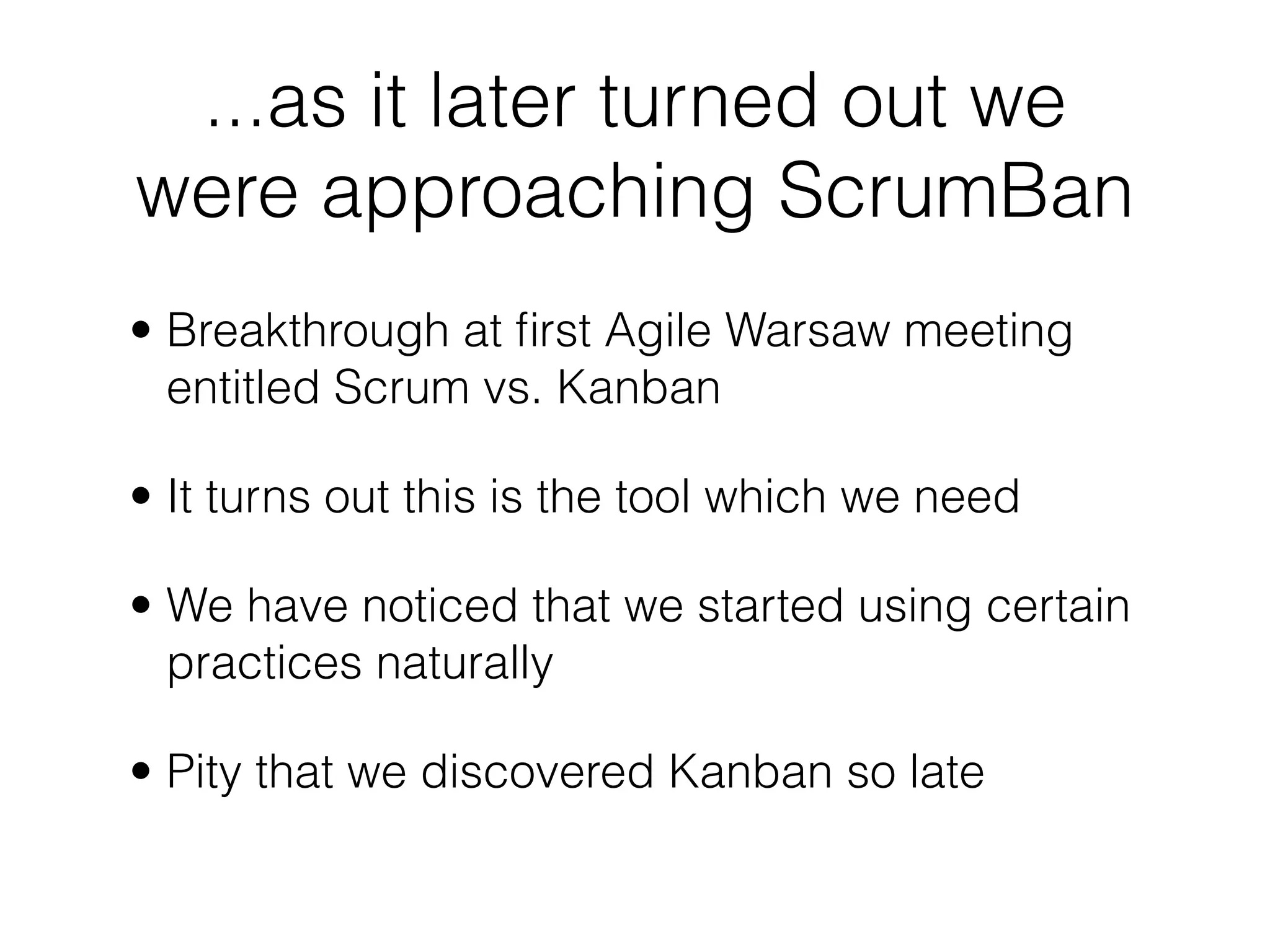

...as it later turned out we
were approaching ScrumBan
• Breakthrough at first Agile Warsaw meeting
  entitled Scrum vs. Kanban

• It turns out this is the tool which we need

• We have noticed that we started using certain
  practices naturally

• Pity that we discovered Kanban so late
SrumBan worked much
       better
     Step 2 - migration to ScrumBan
• We stopped sprints and planning in favour of ad-hoc
  planning and estimation on daily basis

• Limit to number of WIP tasks per person

• Highest priority for fuckups and errors

• Reorganising the teams - 3 teams: devel, telco, operations

• Individual task states for each team
Task board - Telco

Task board - Devel
Task board - Operations
ScrumBan - observations
• We had the pleasure of working in the new arrangement
  for 2 months

• Decreased level of frustration with the process was evident

• Increase in productivity and quality of work of the teams

• Shorter time from submission to delivery of task

• ScrumBan did not solve all of our problems but it did solve
  most of the problems associated with the process,
  increasing the comfort of work

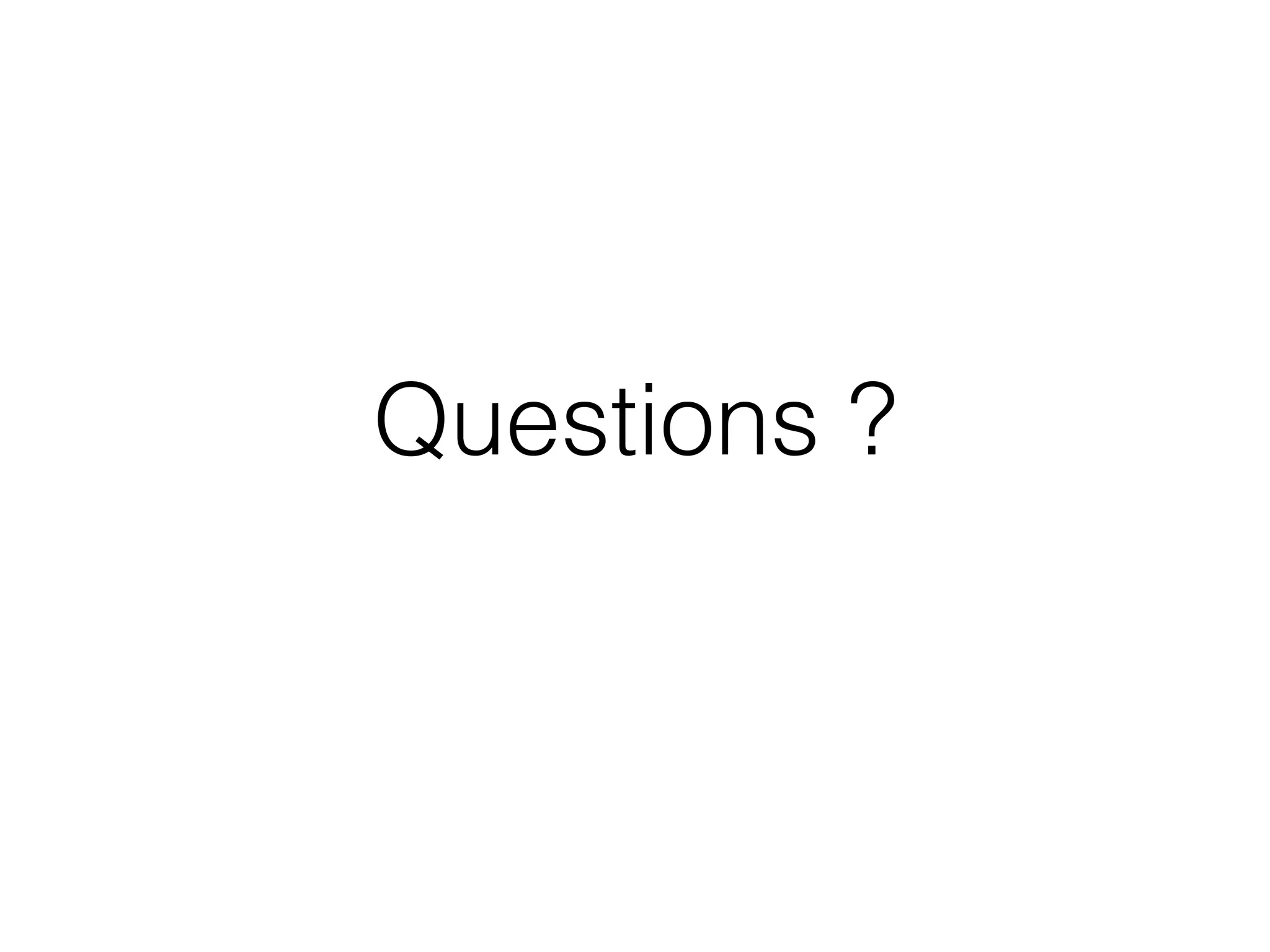

Questions ?
Thank you.
